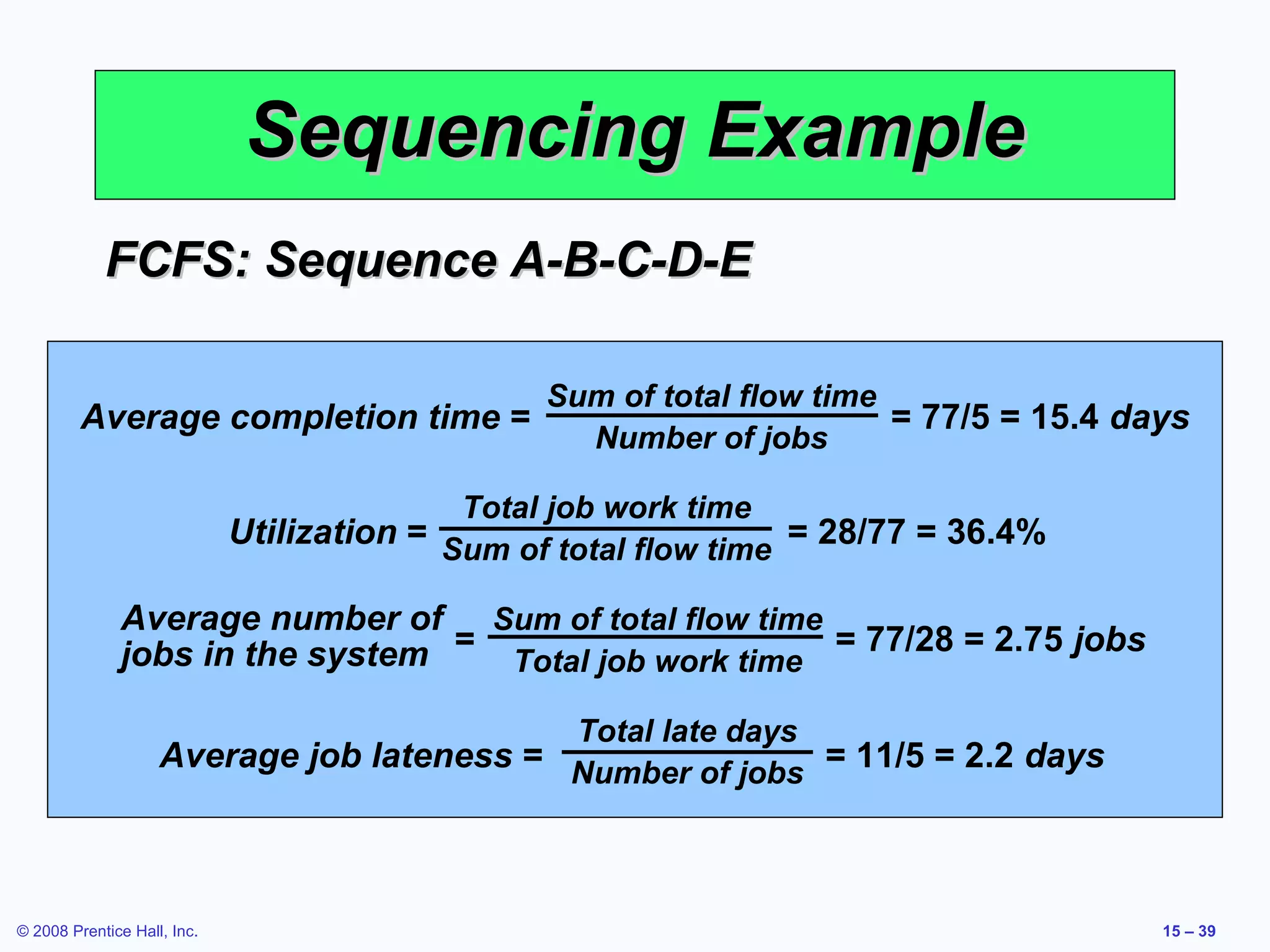

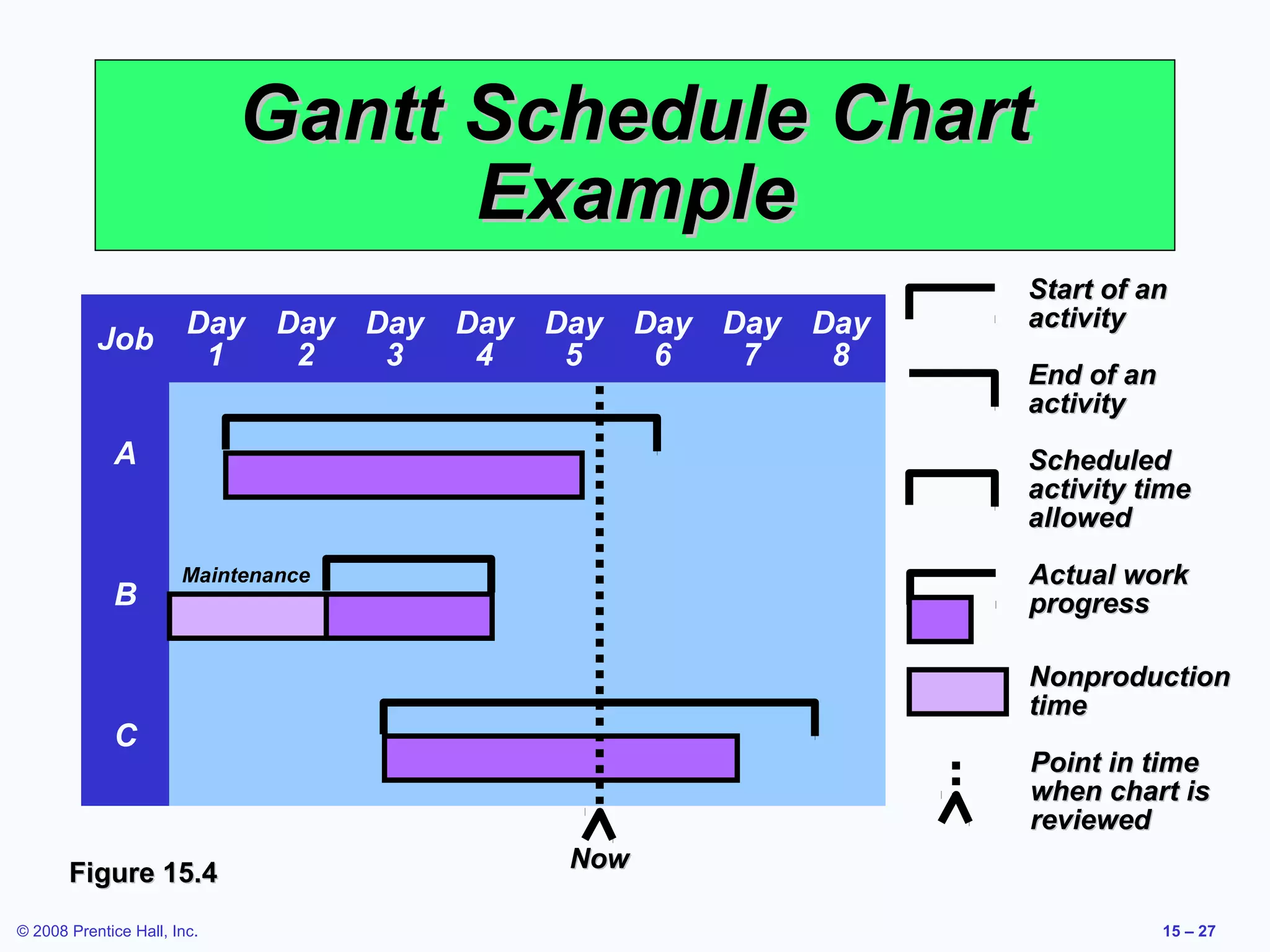

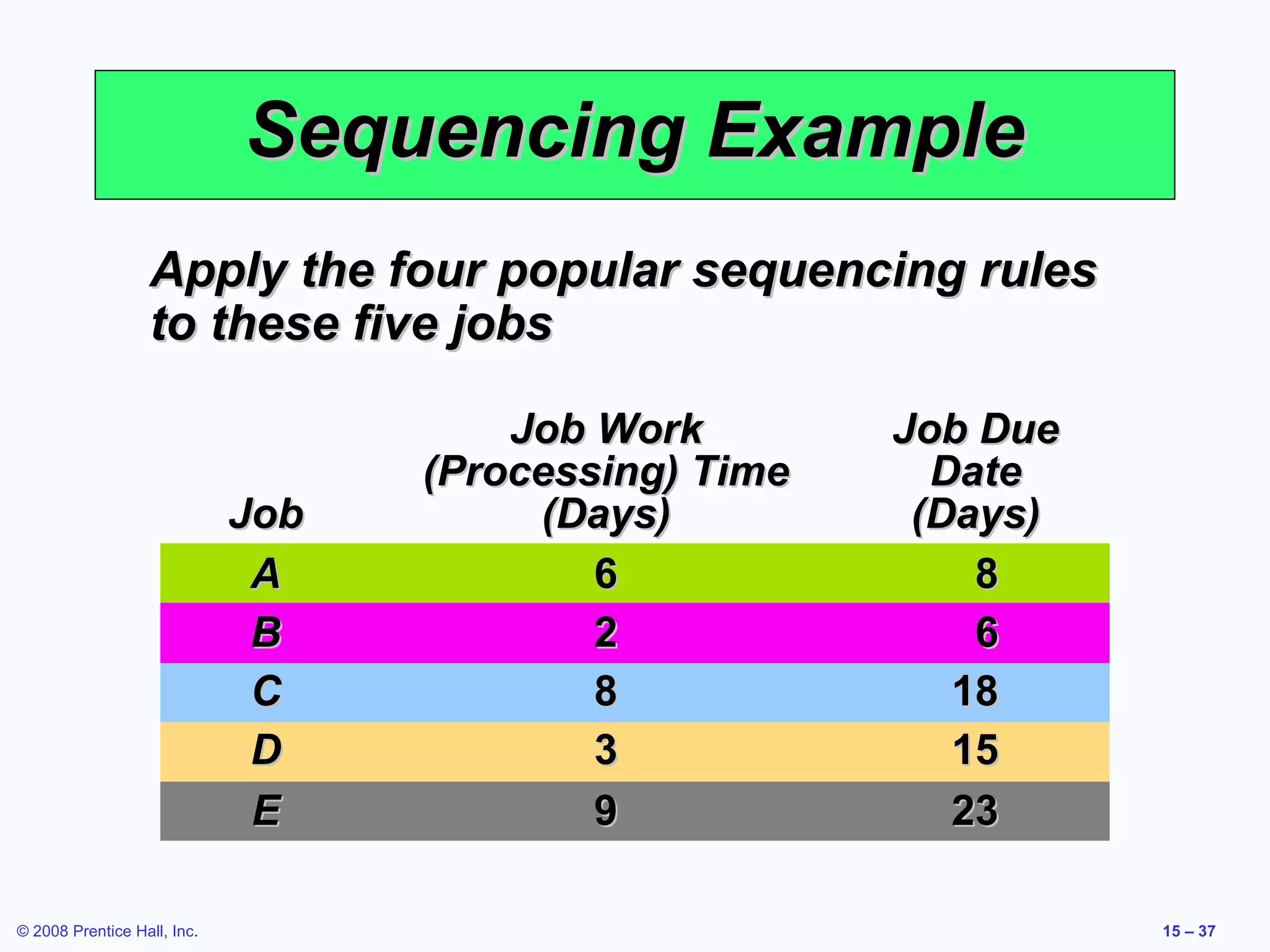

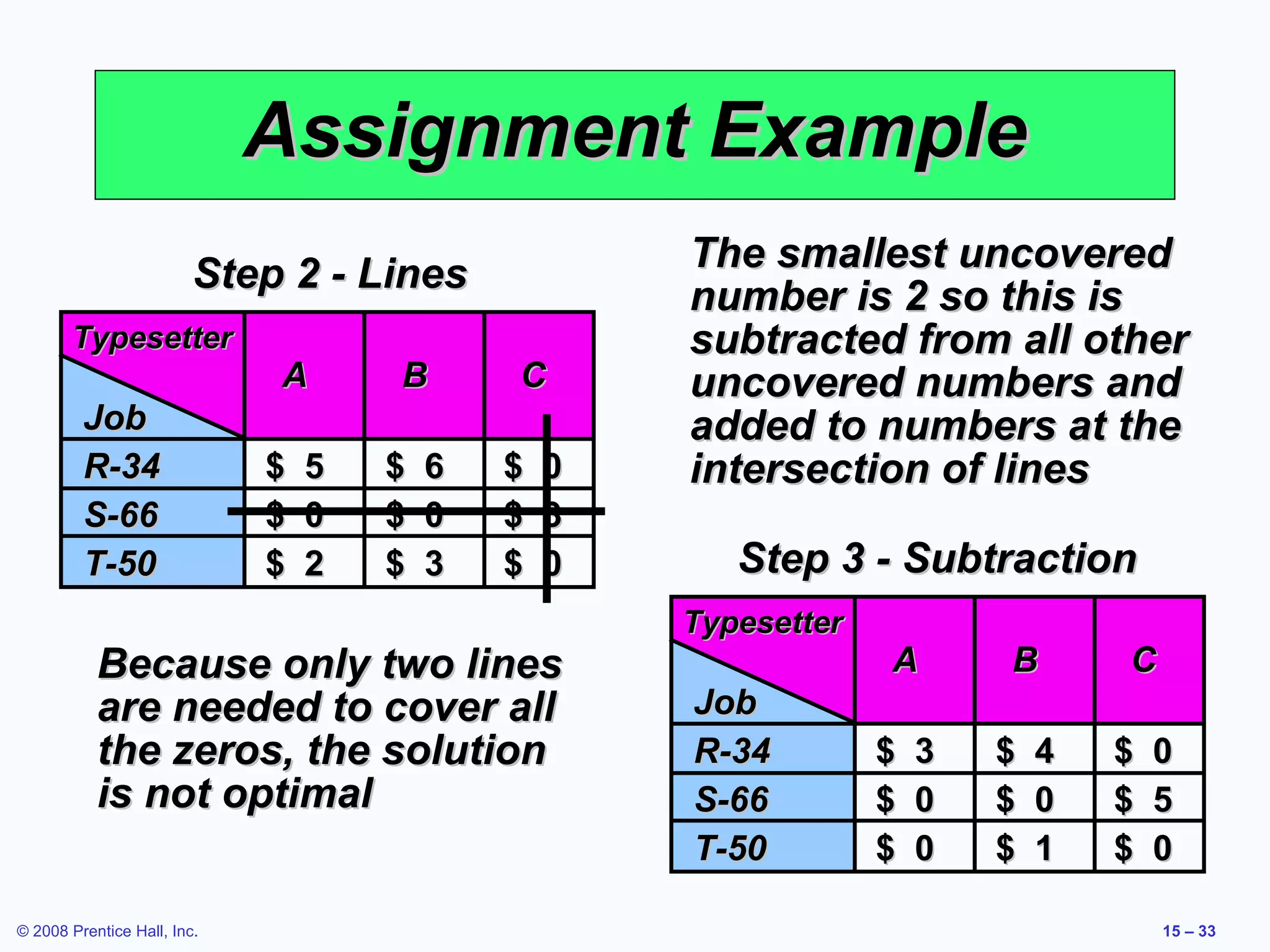

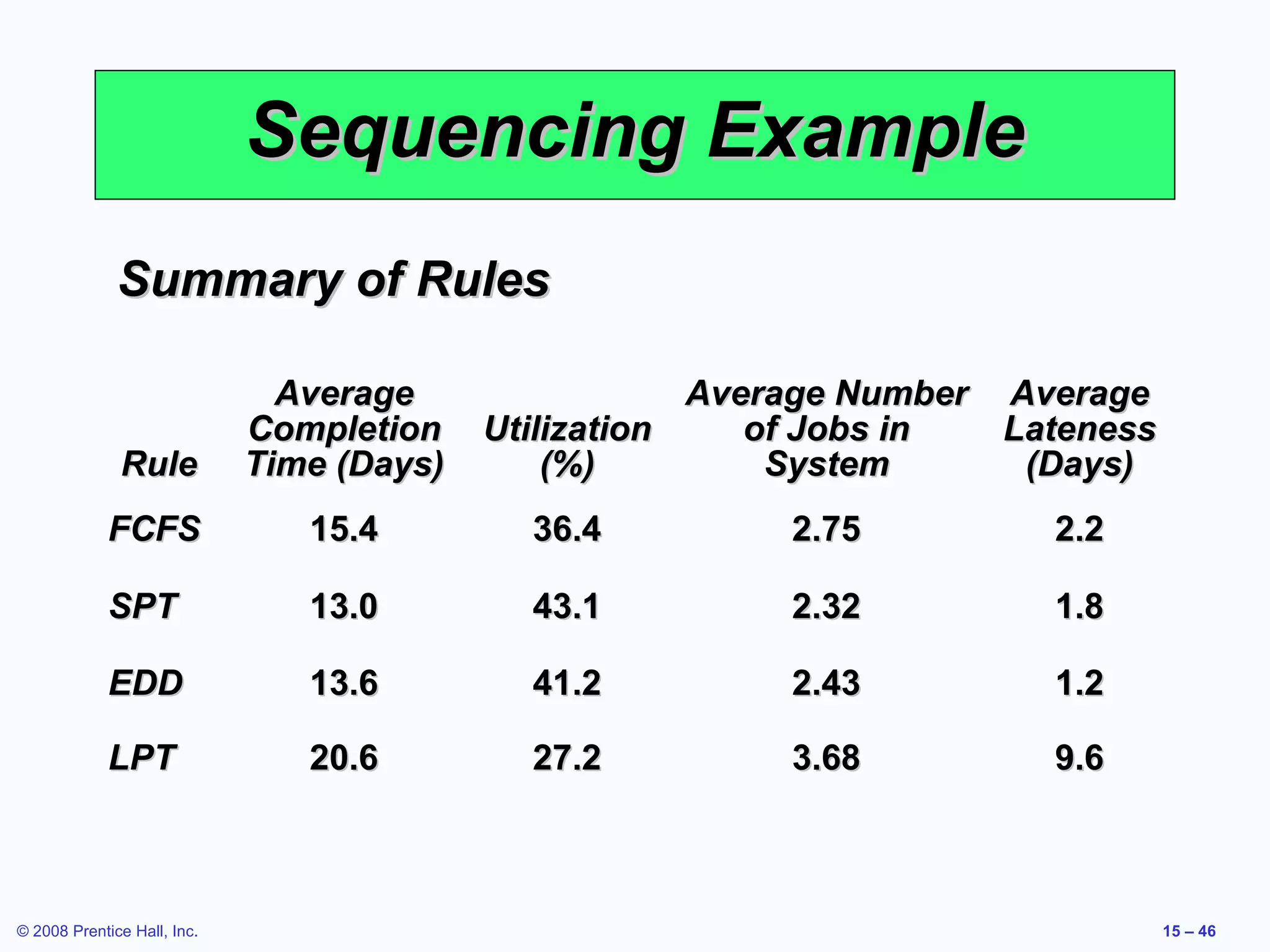

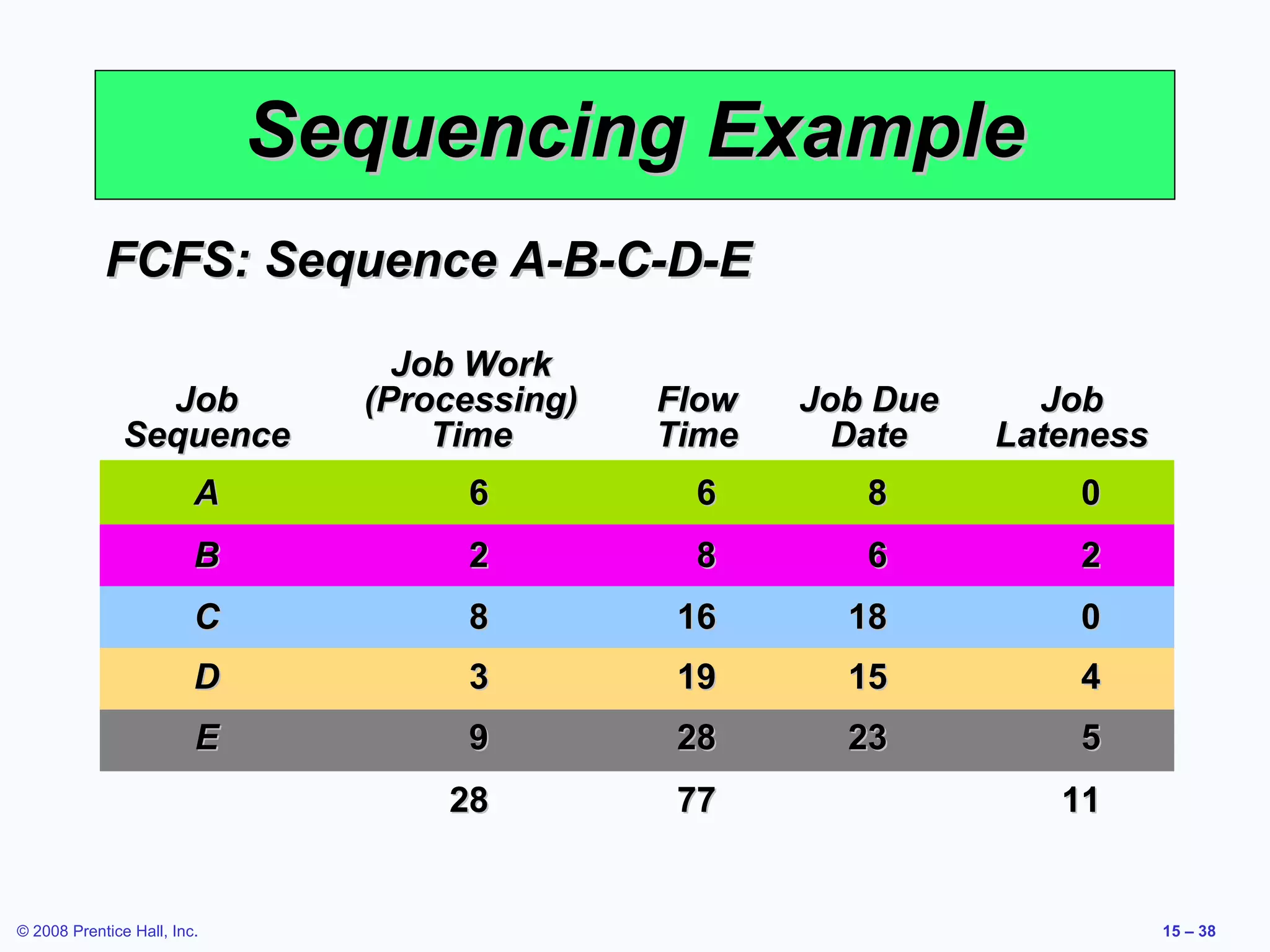

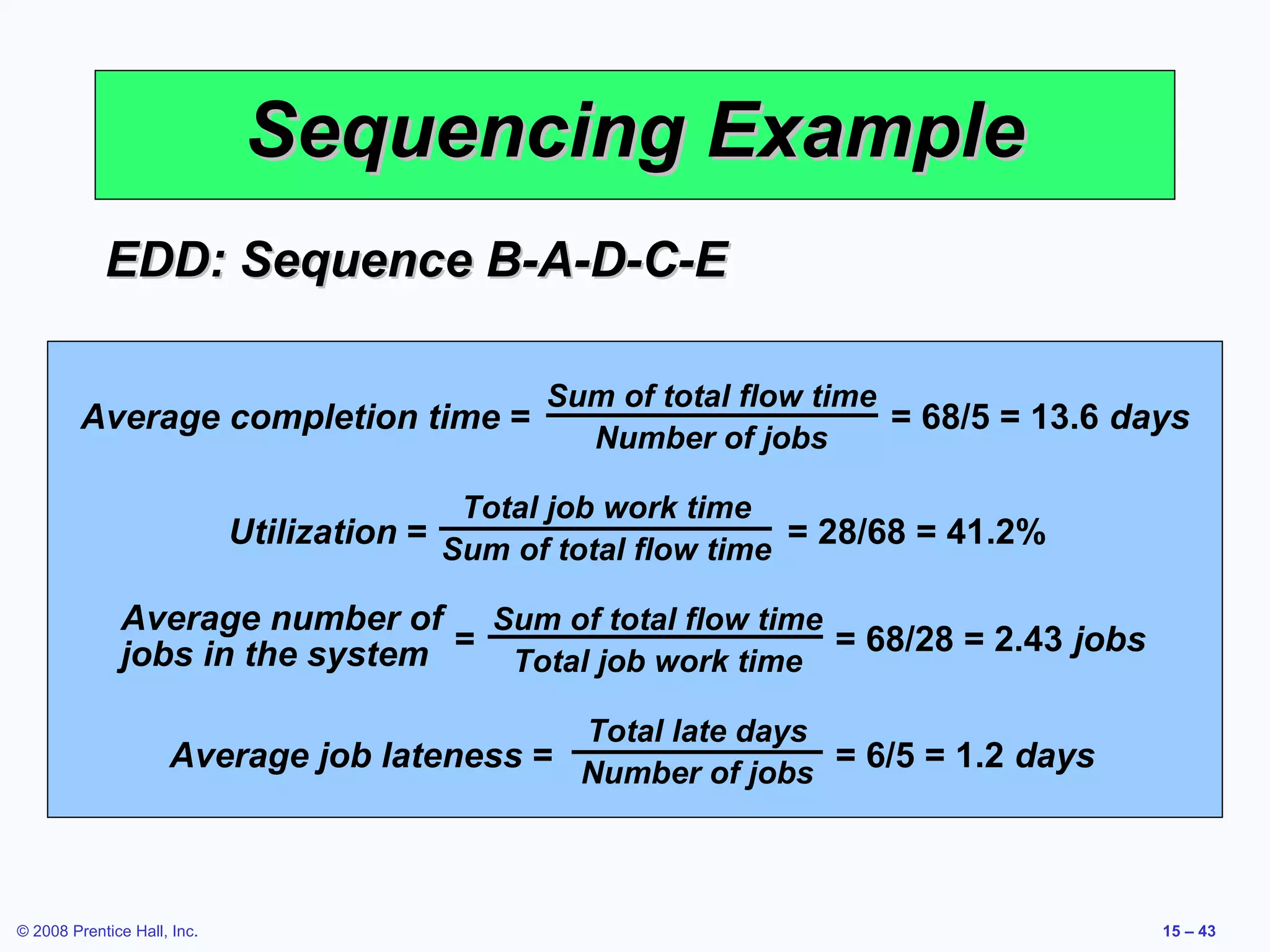

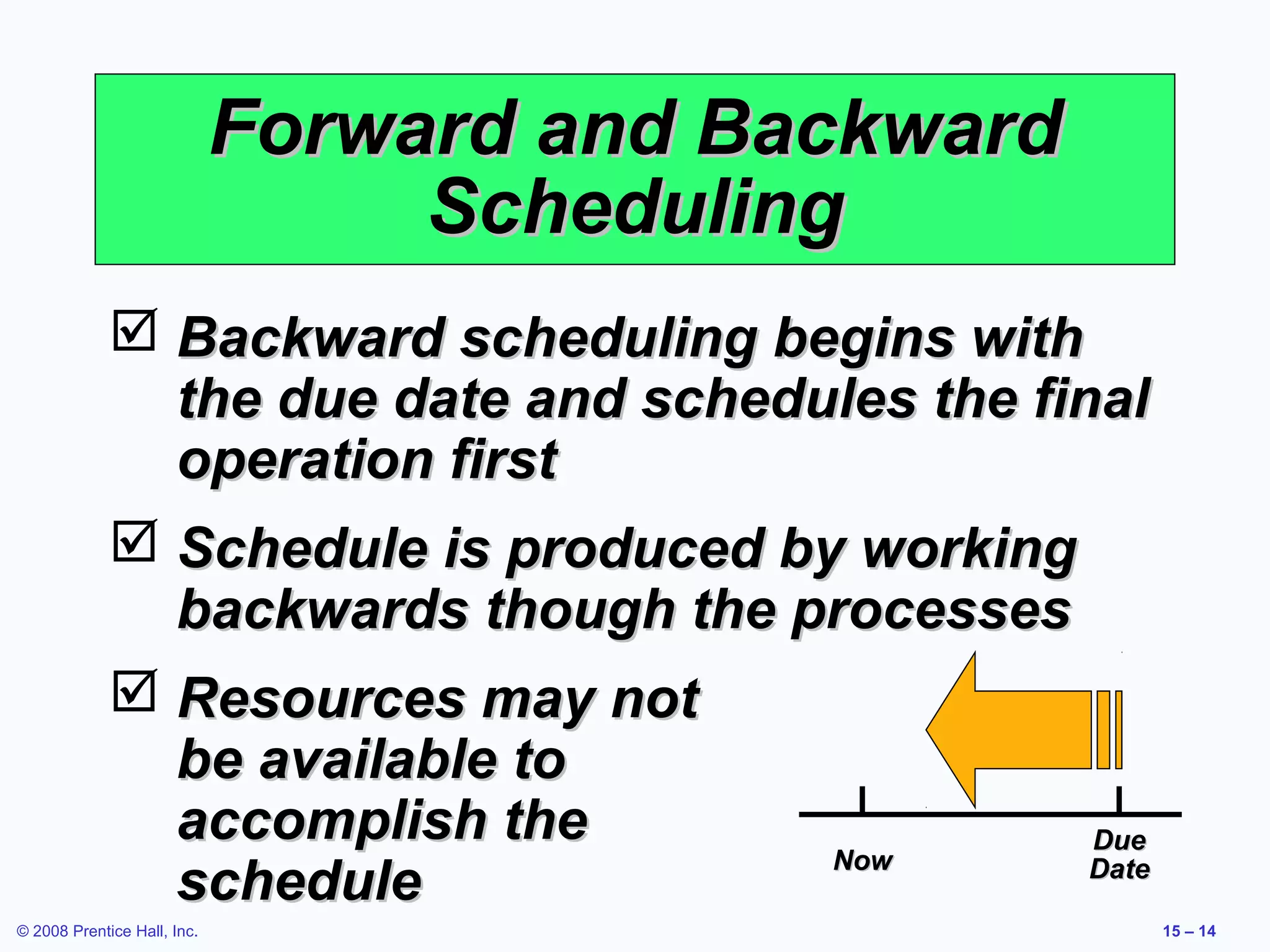

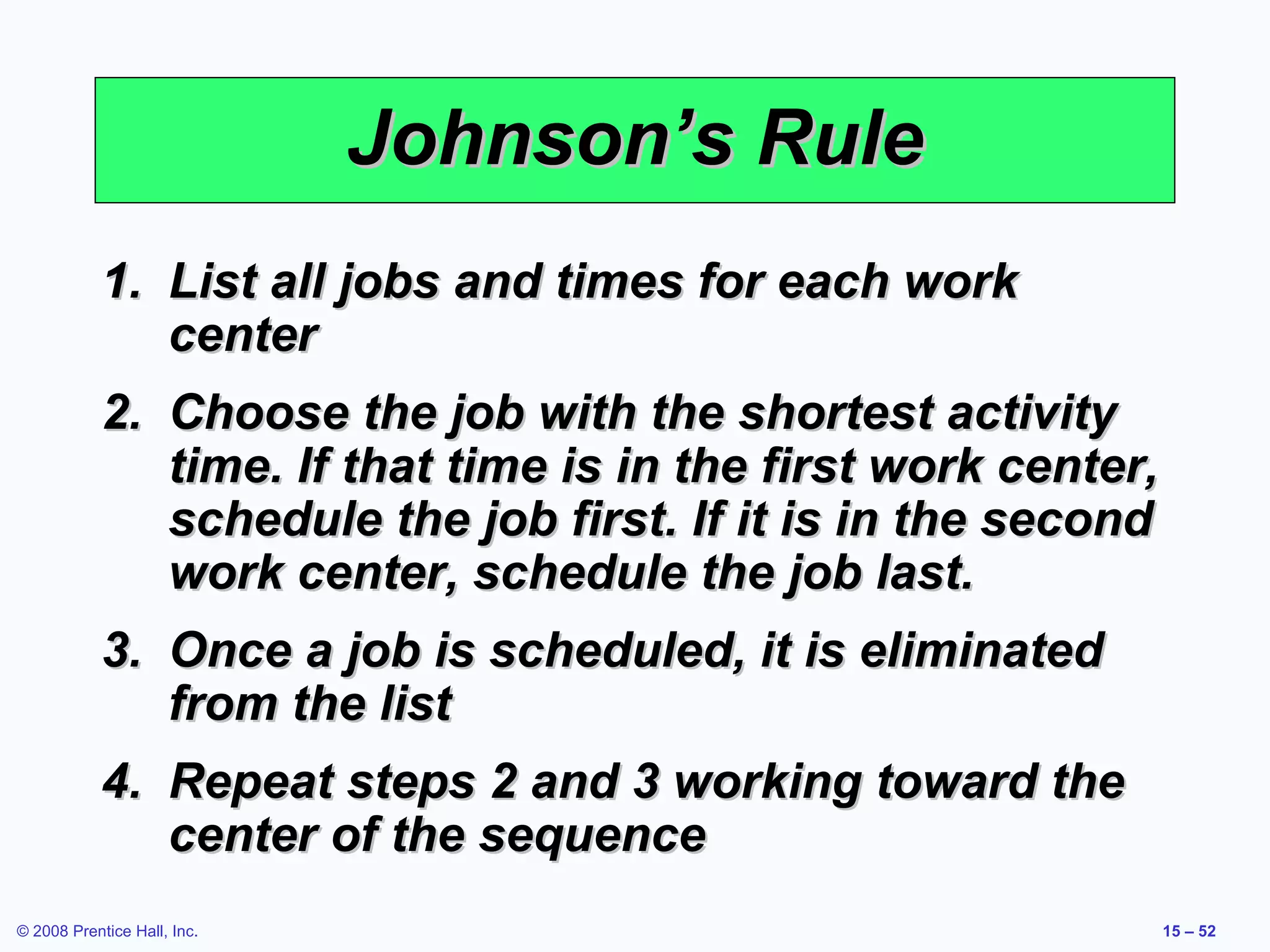

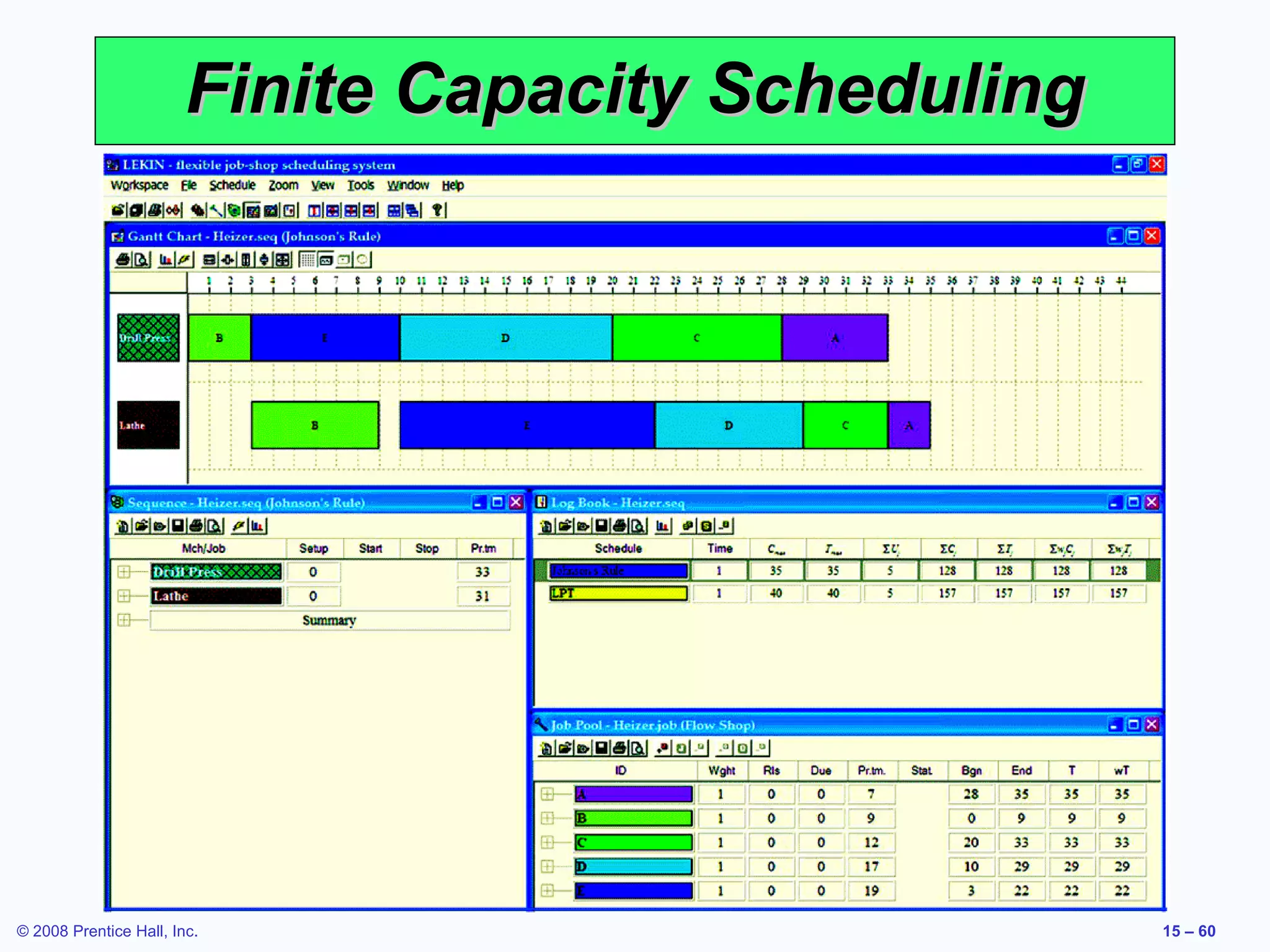

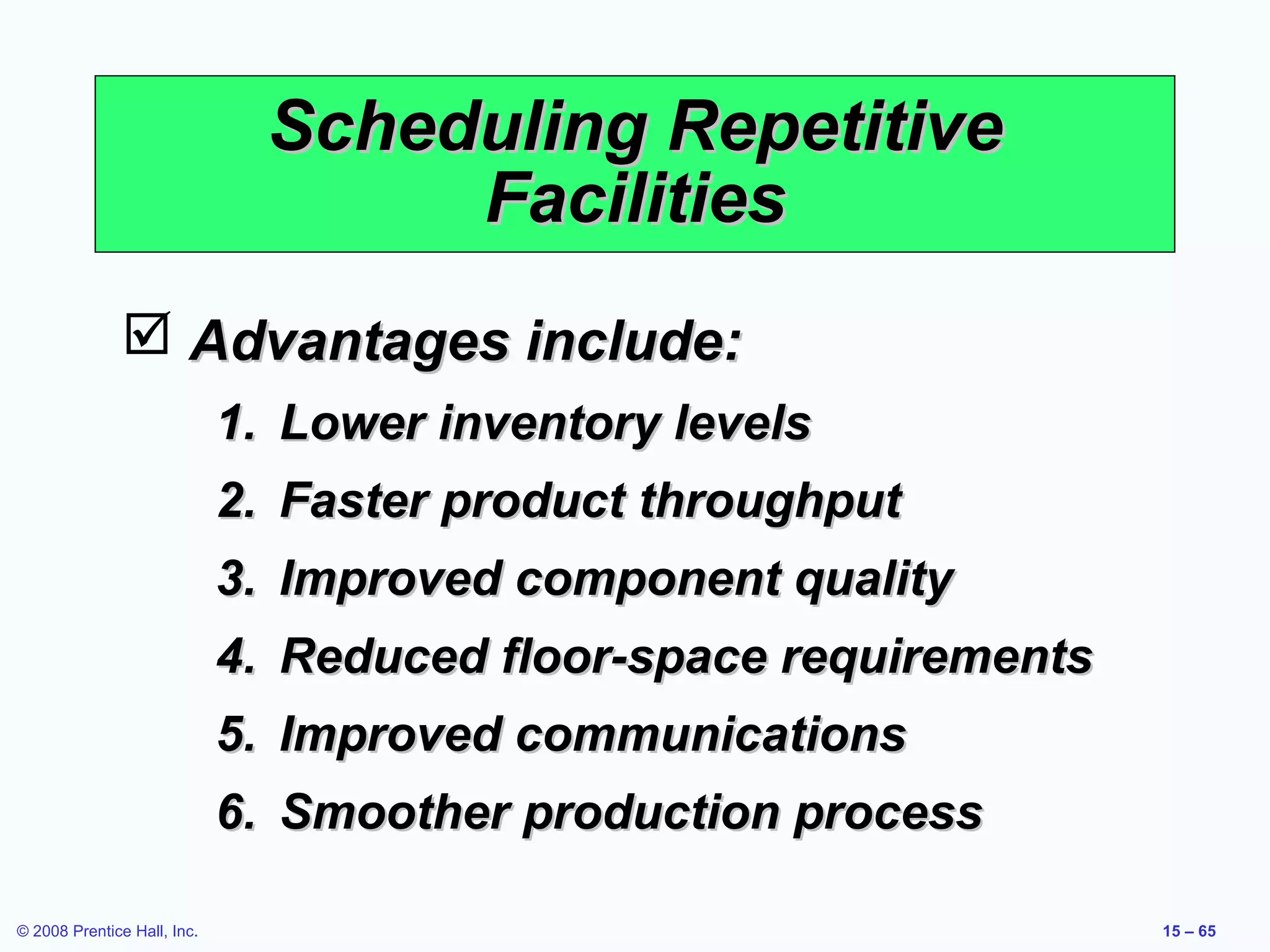

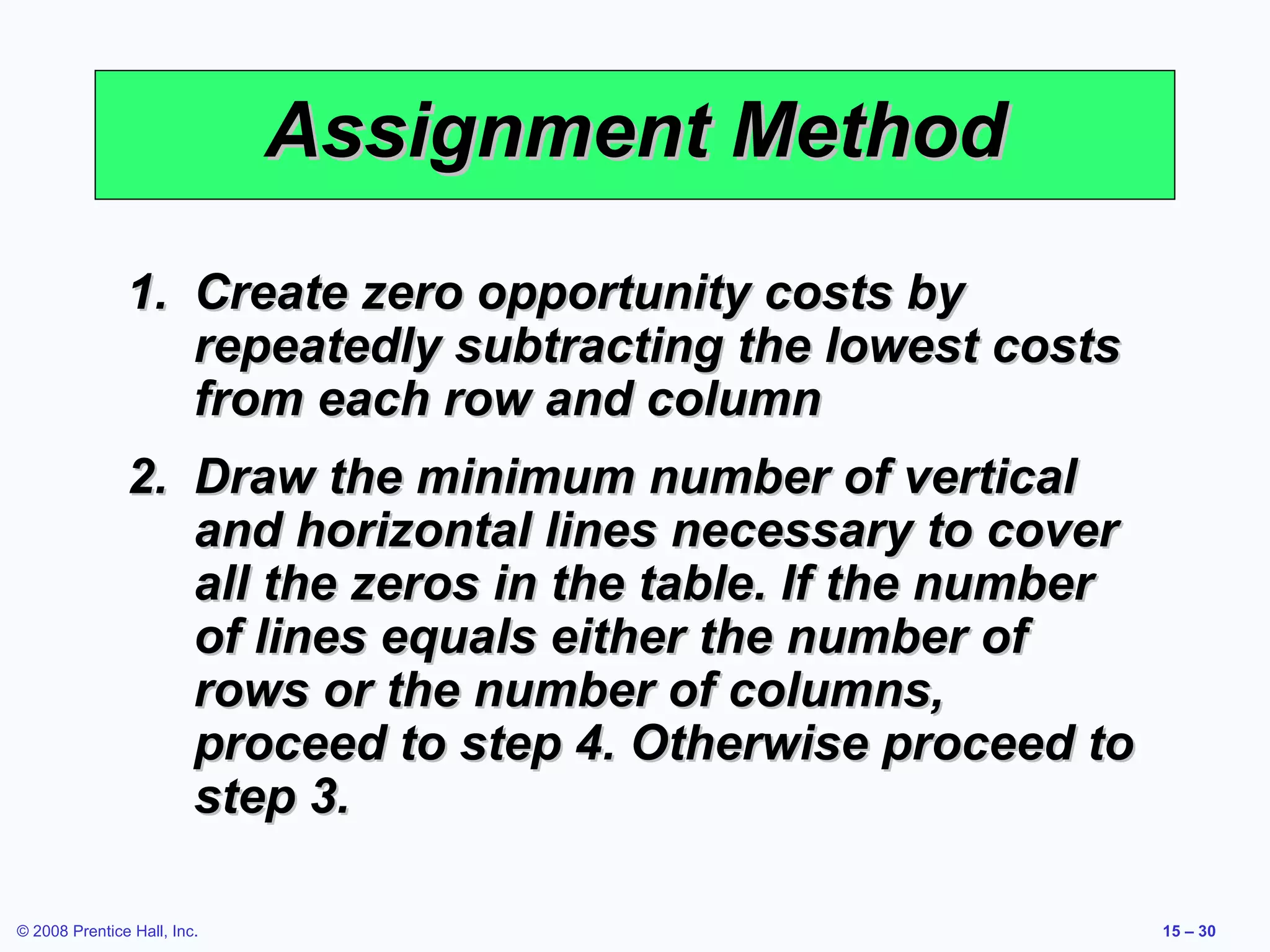

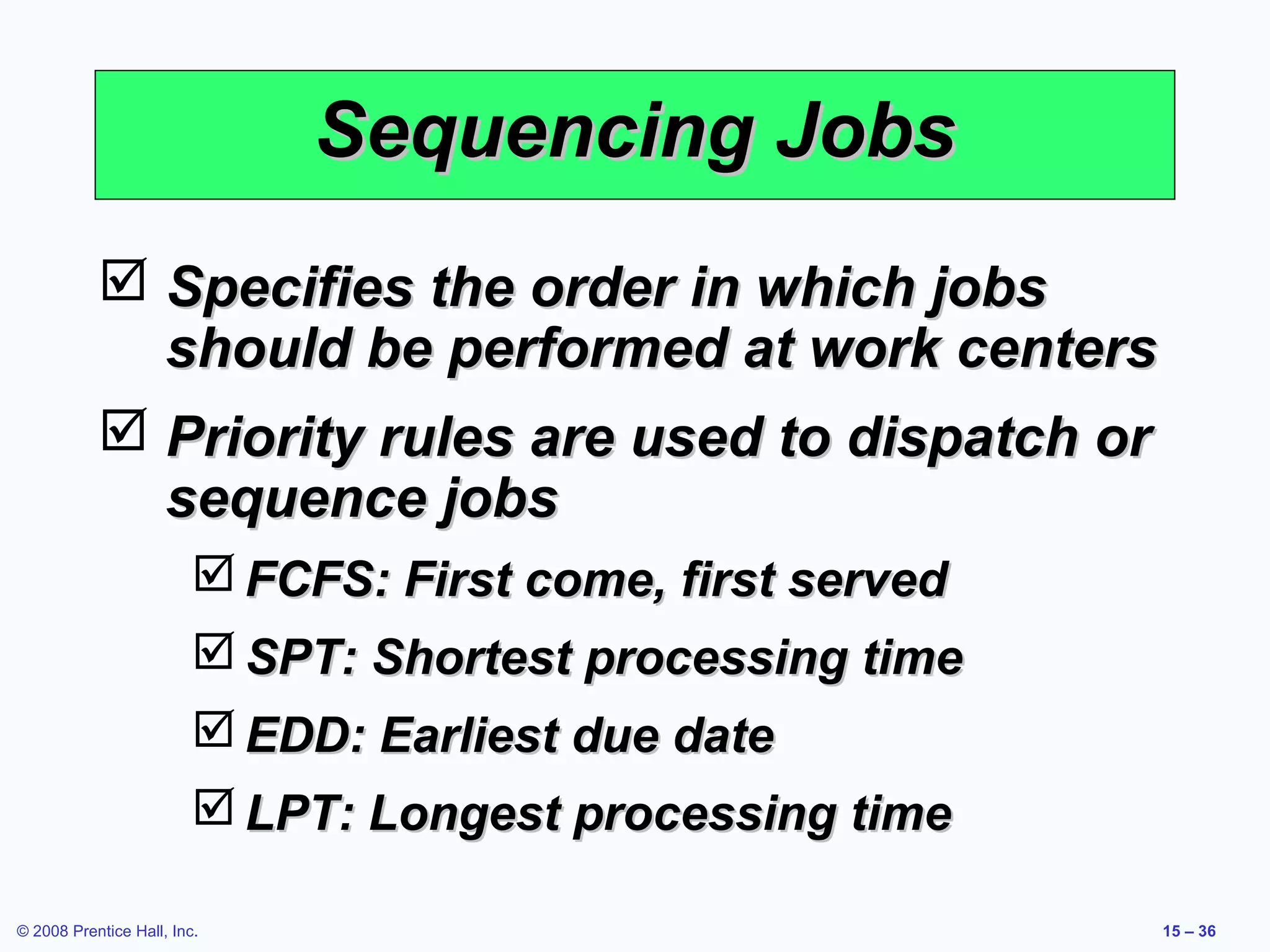

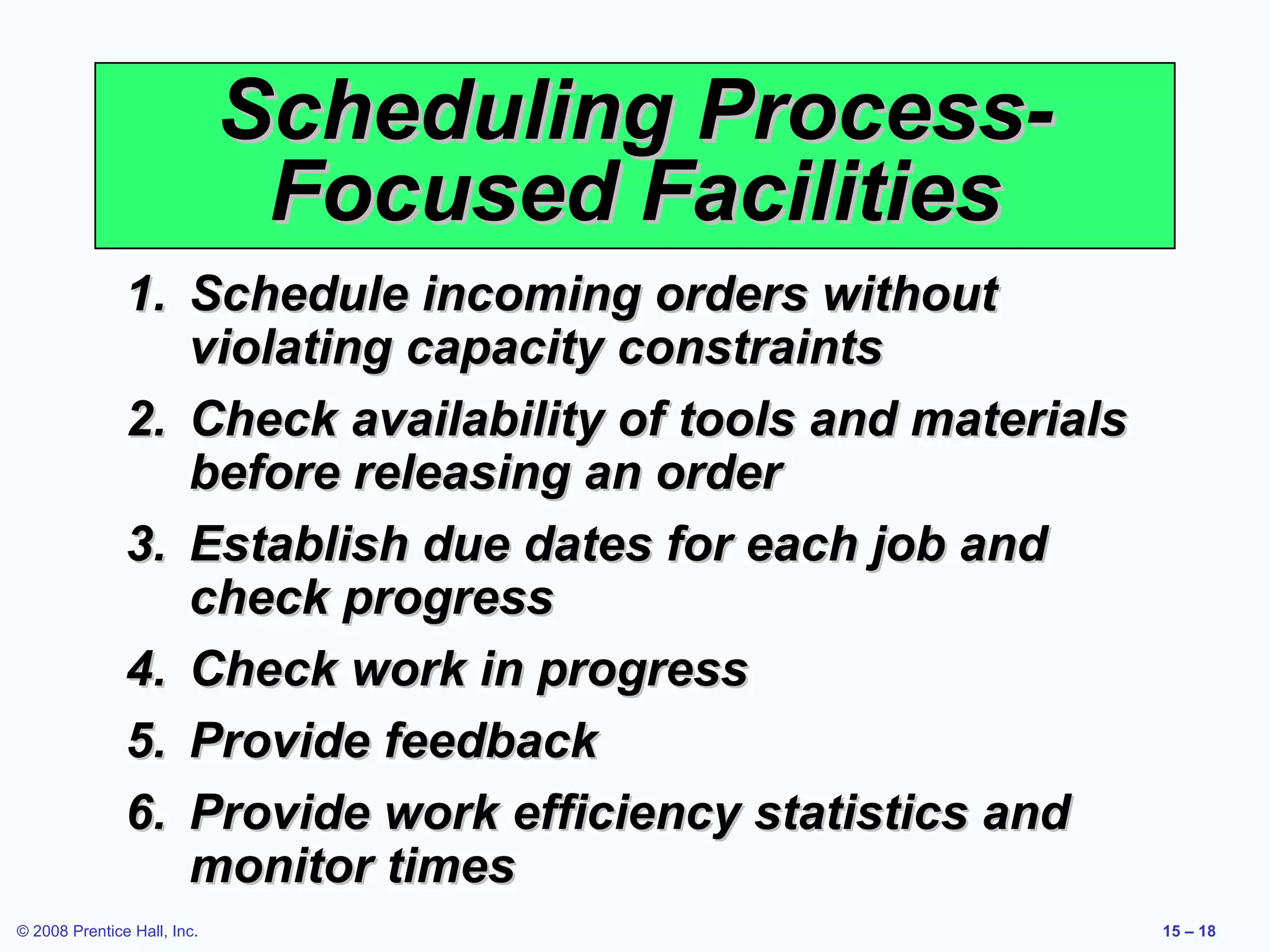

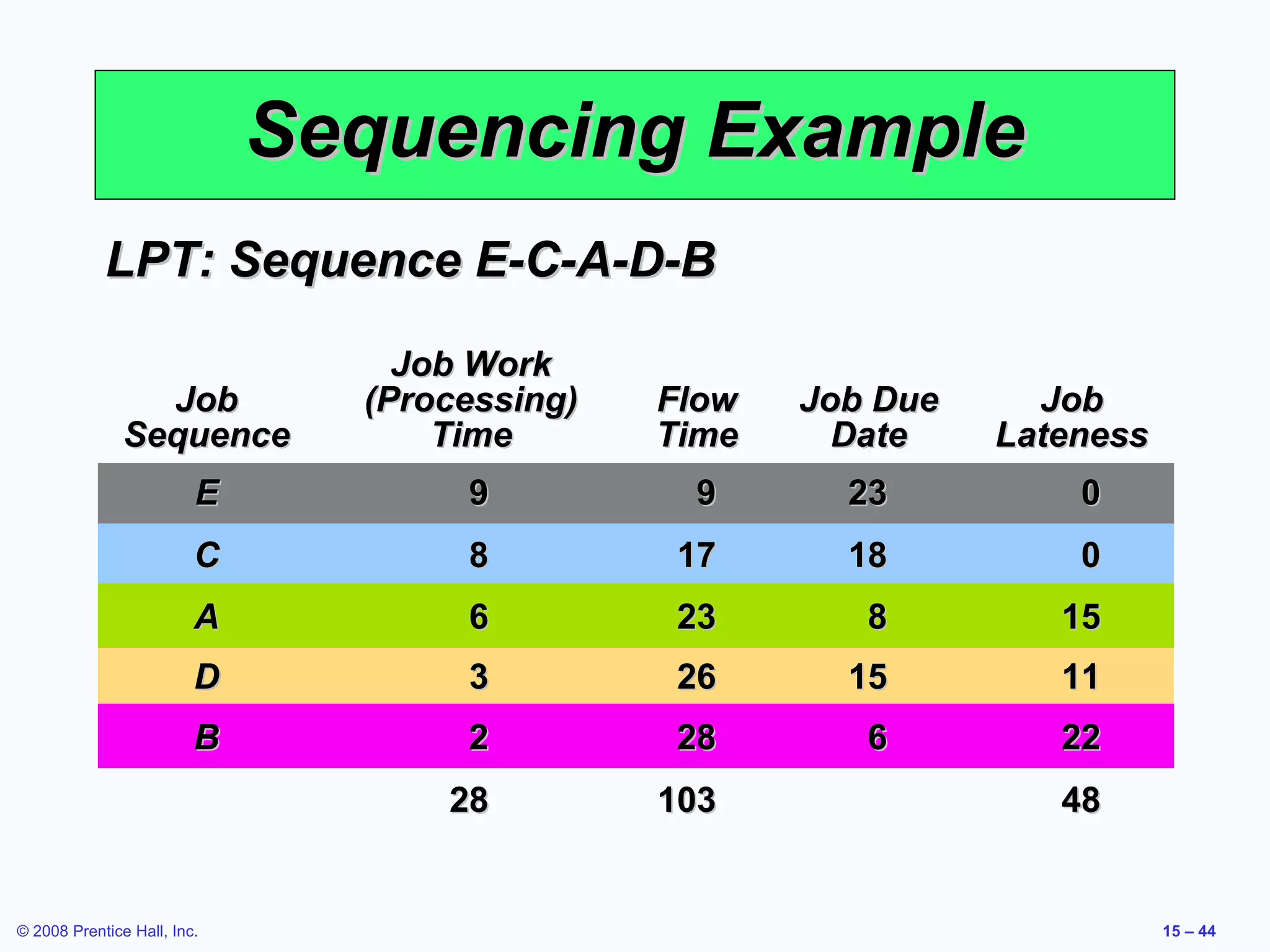

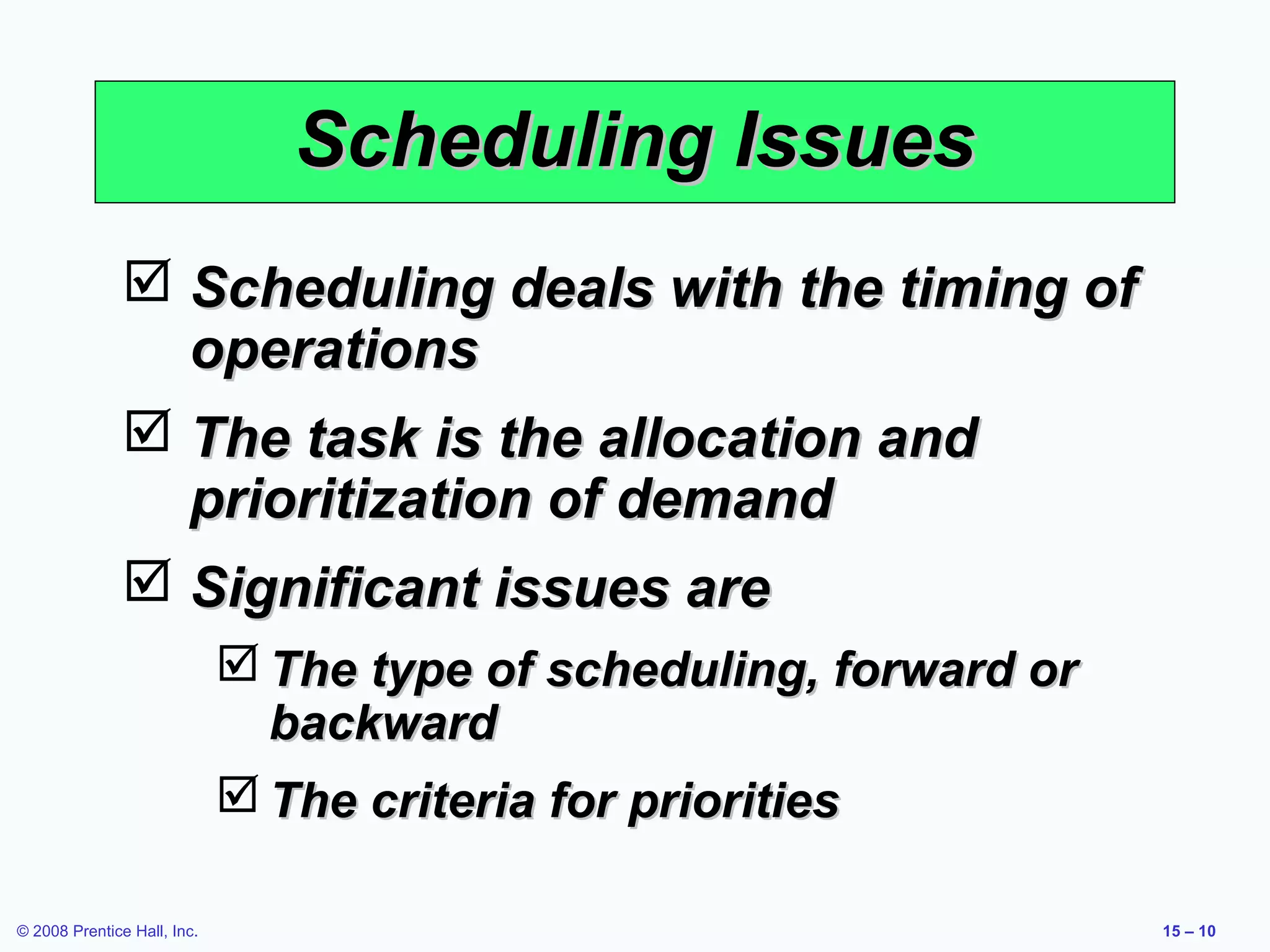

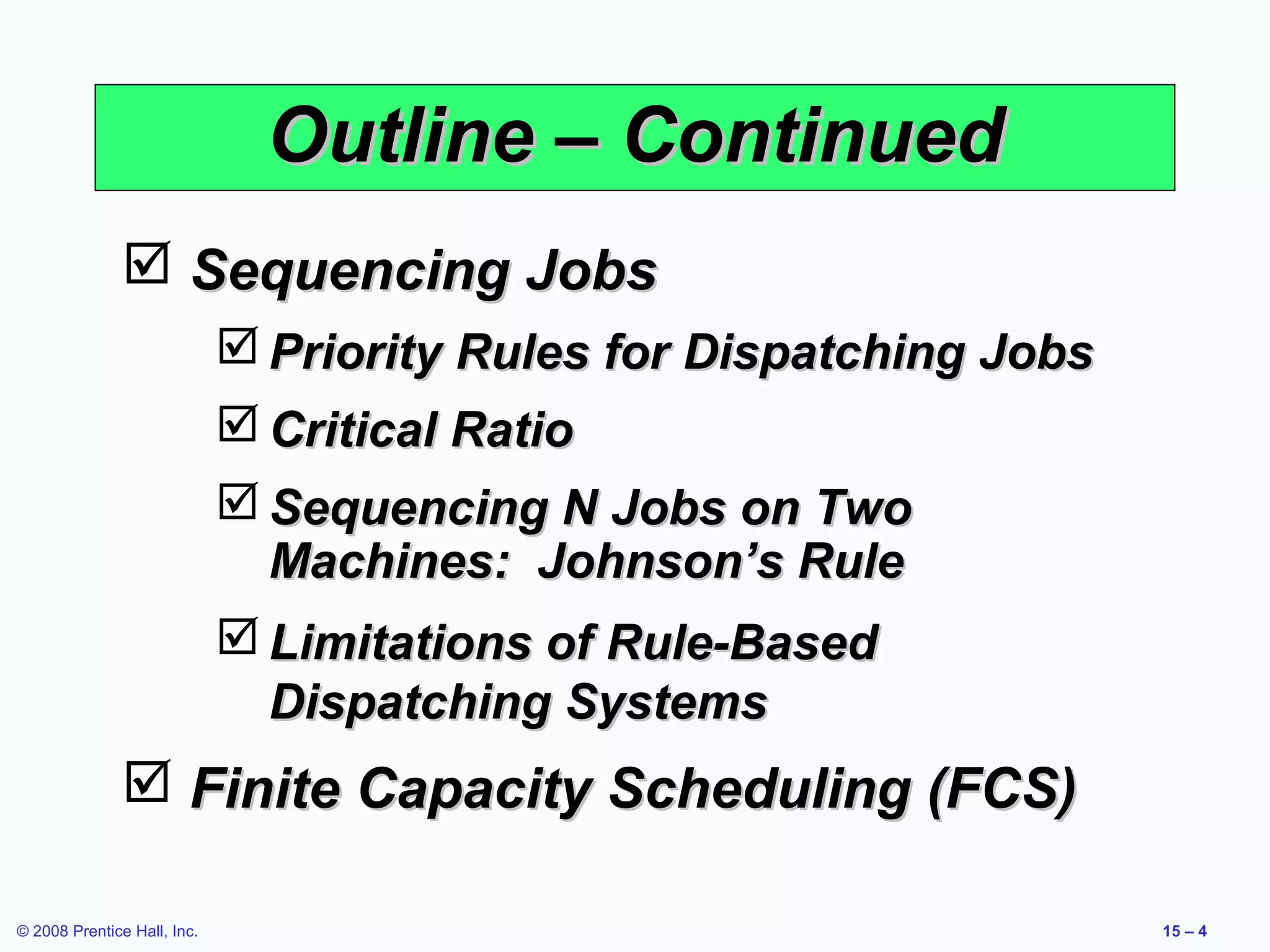

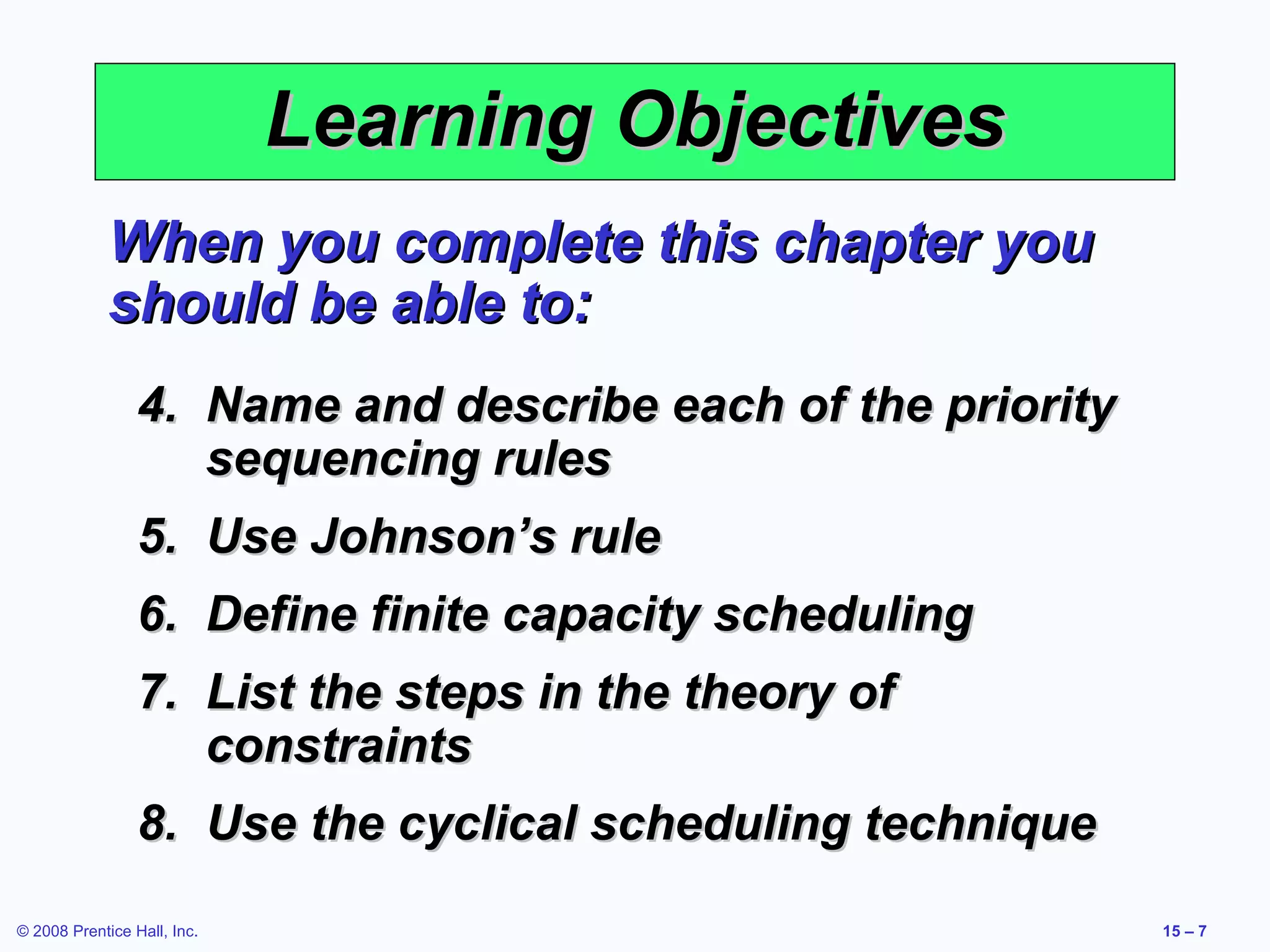

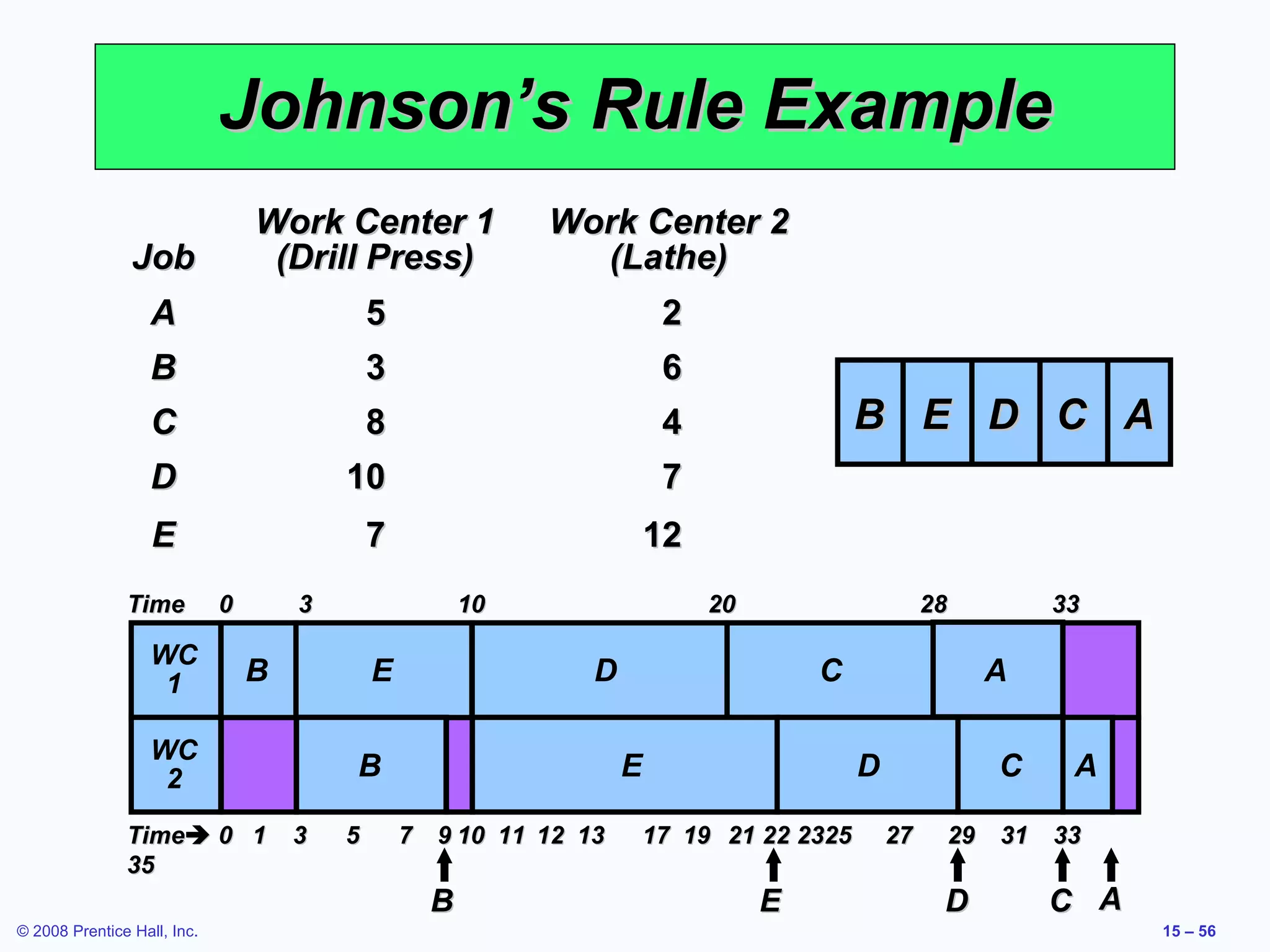

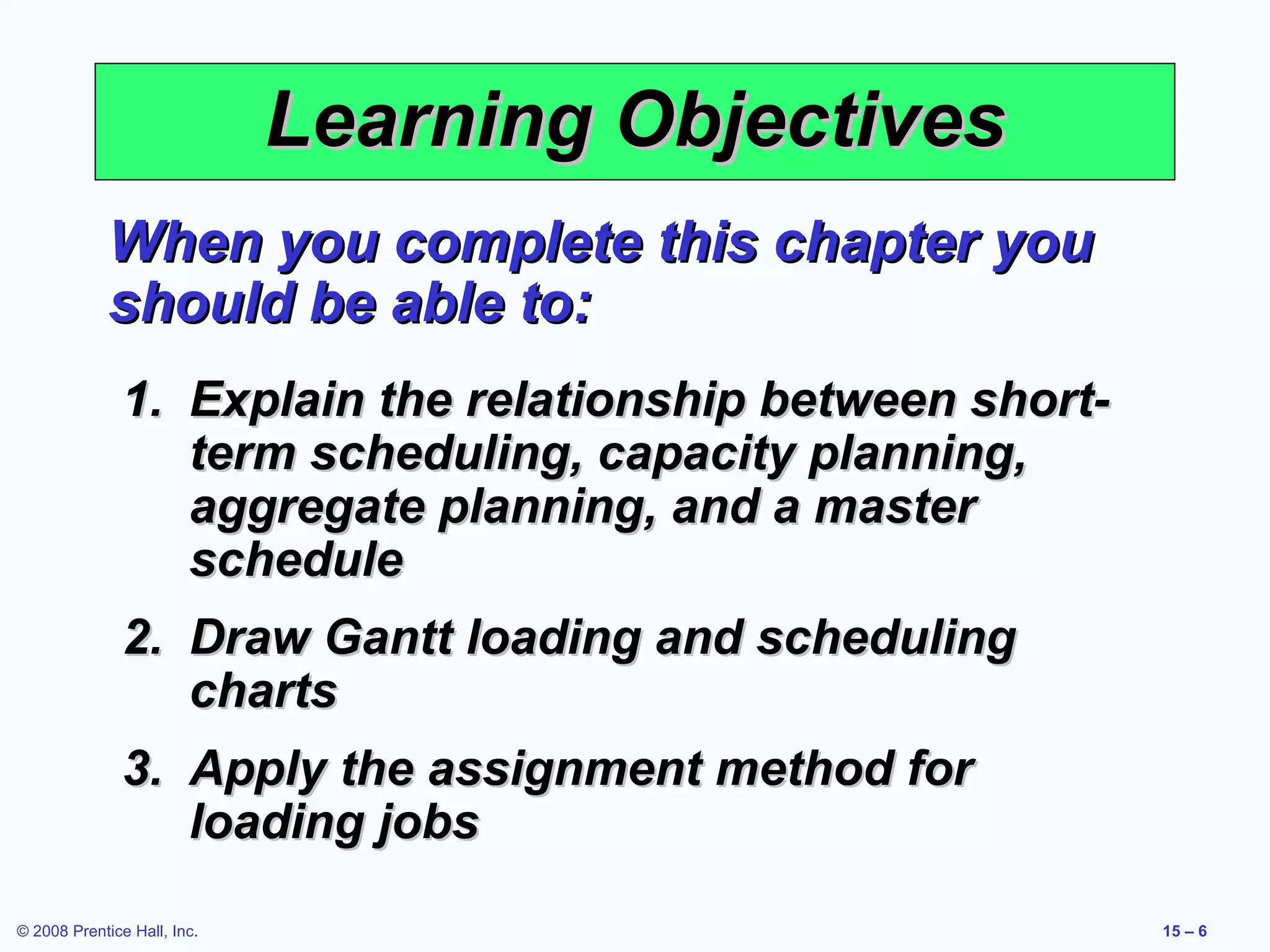

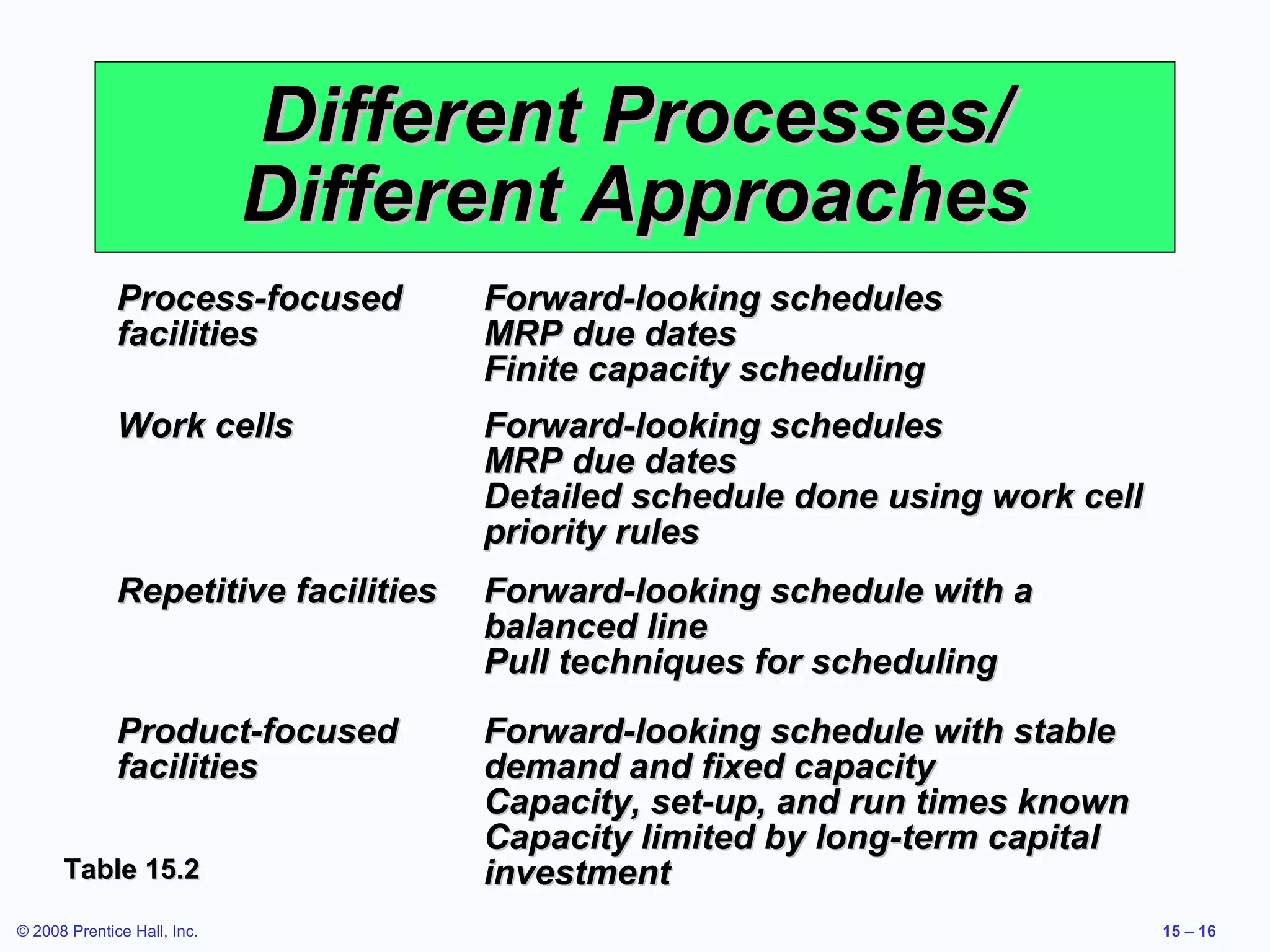

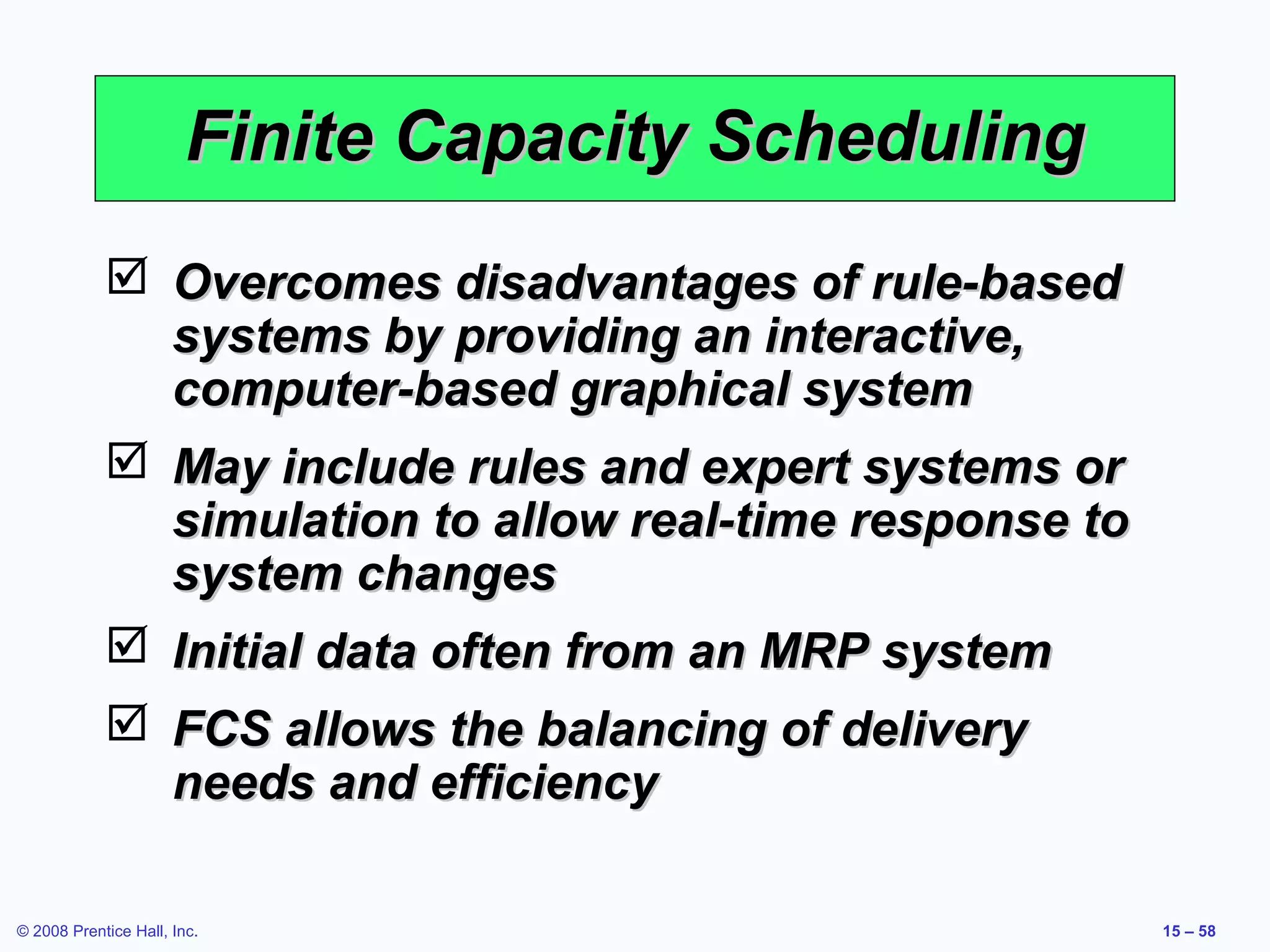

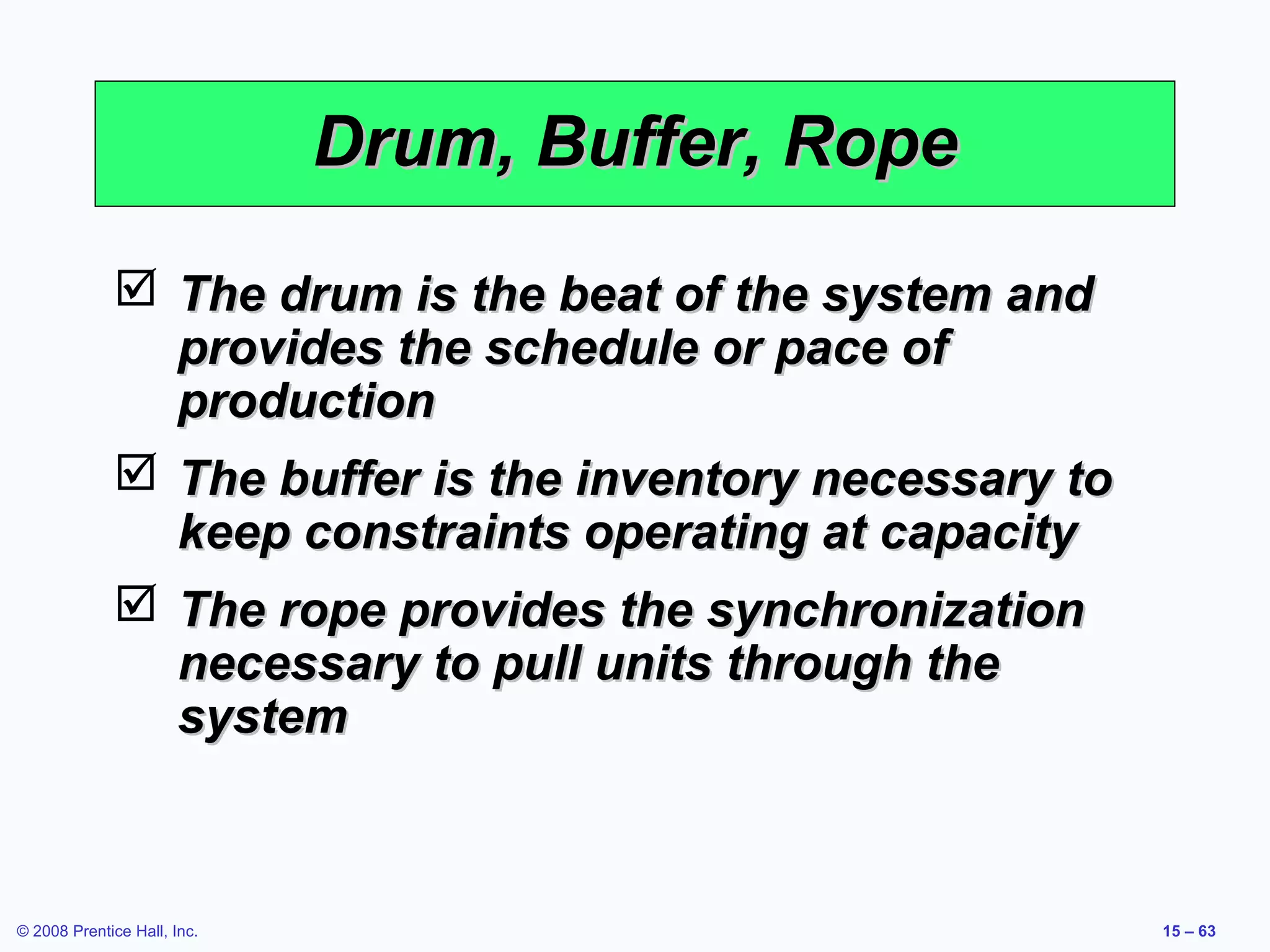

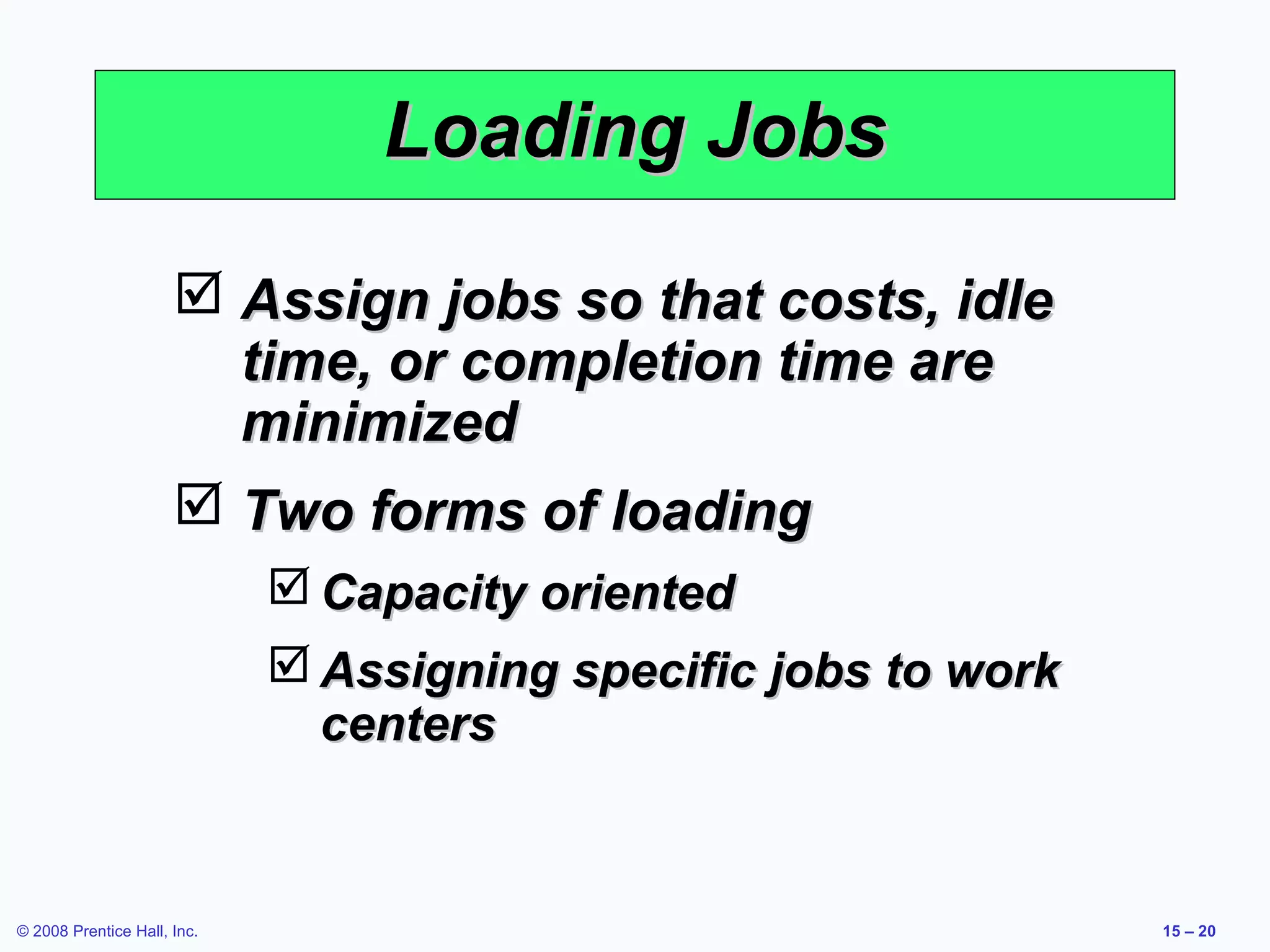

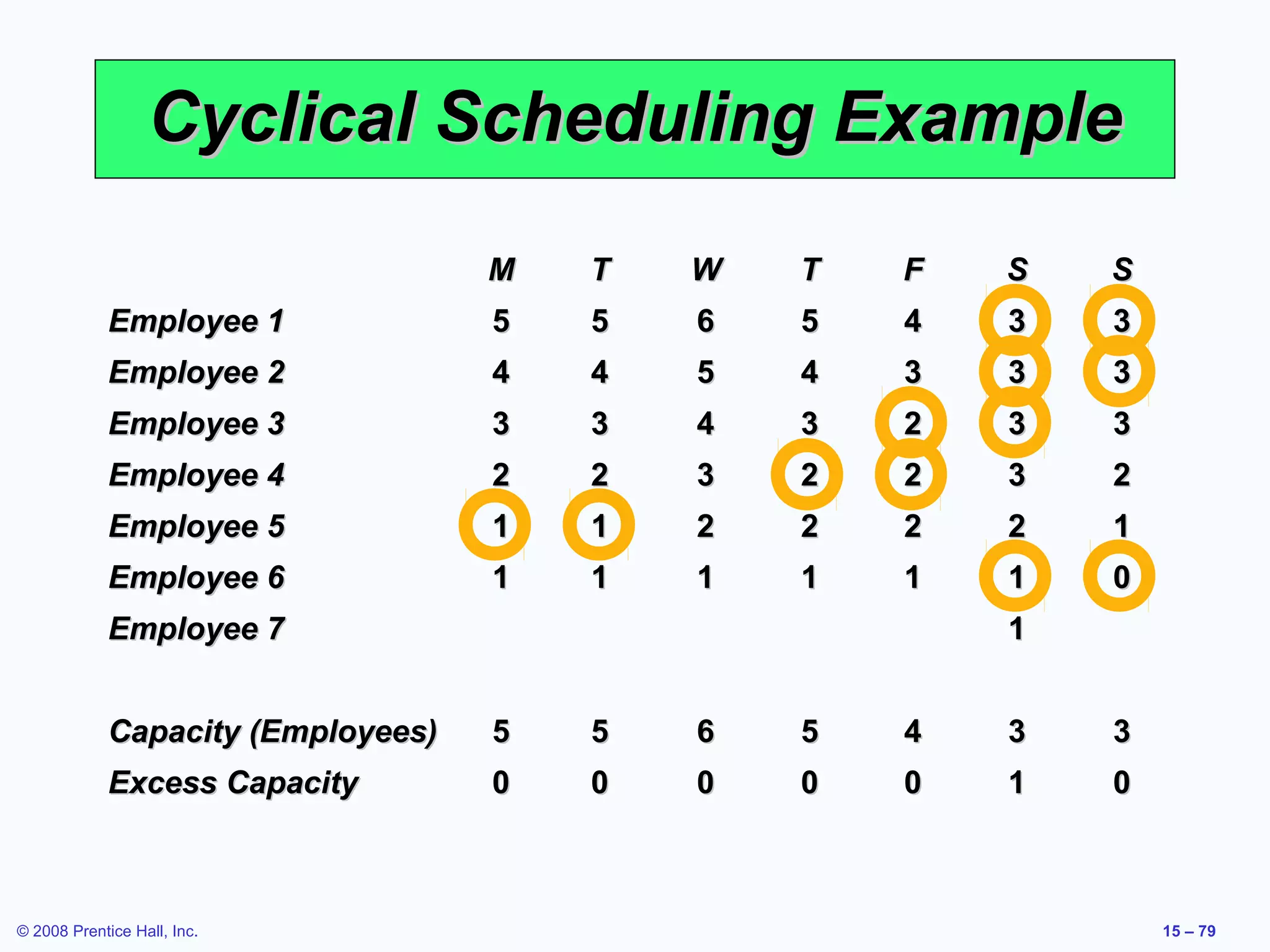

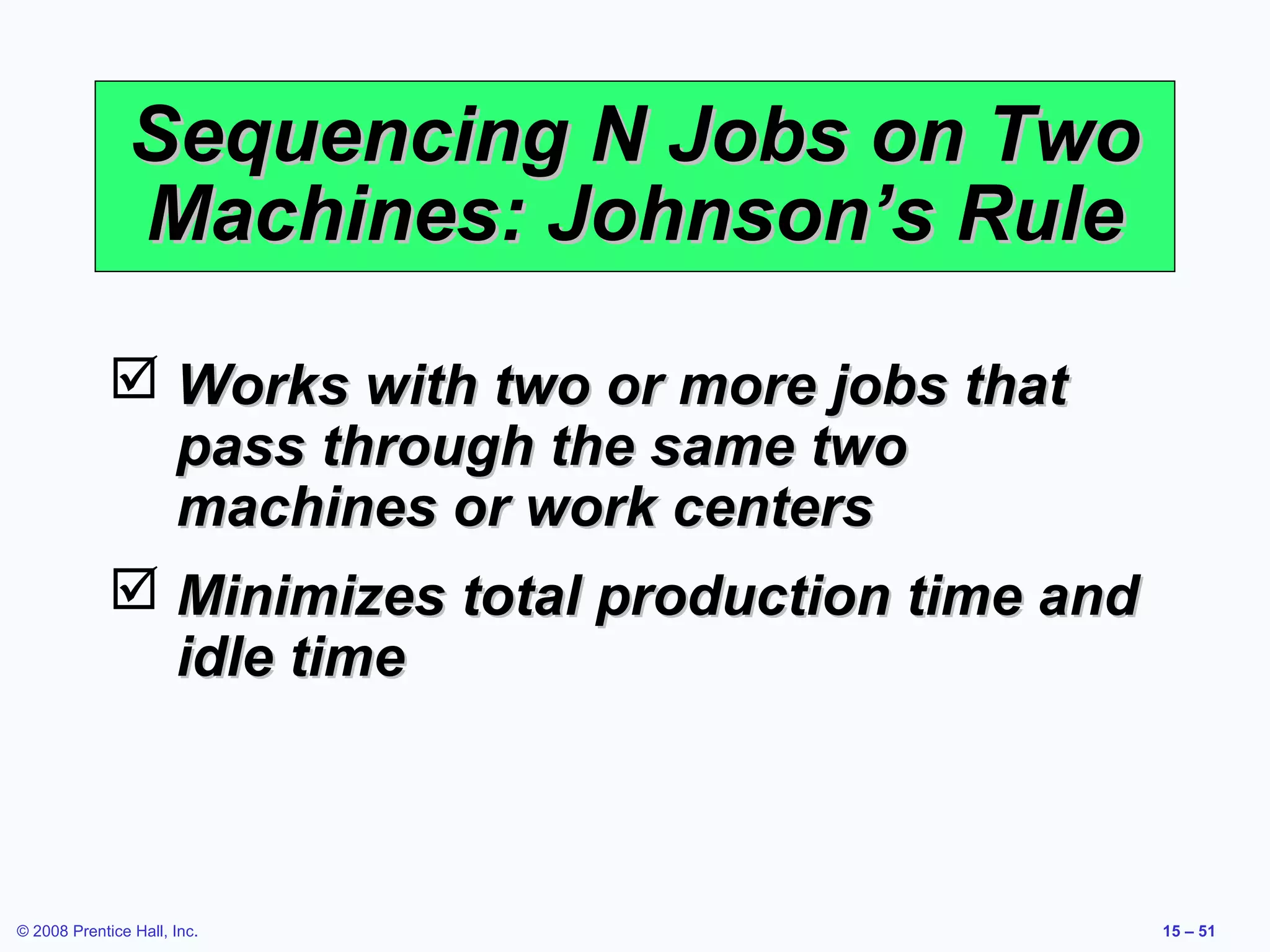

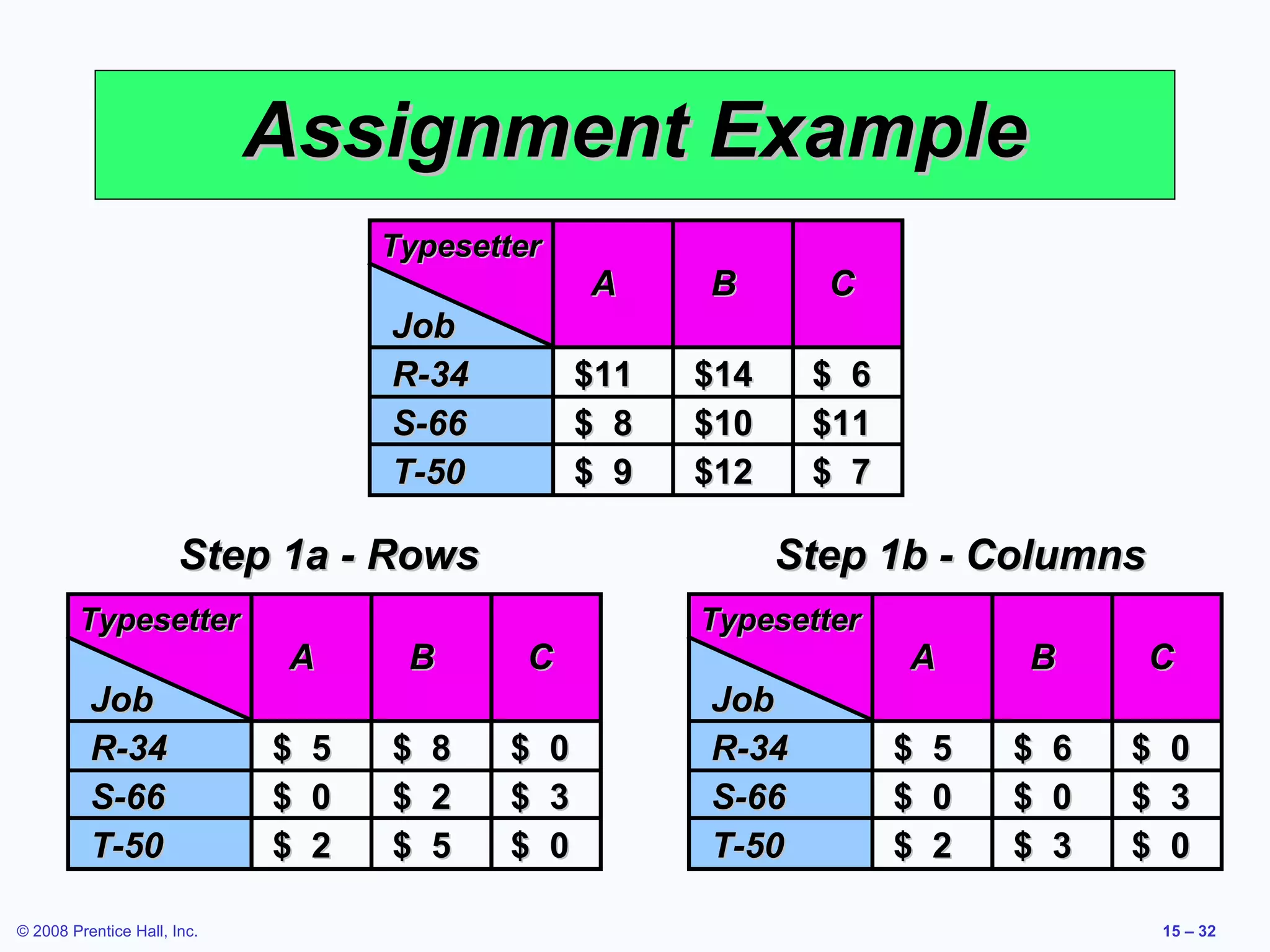

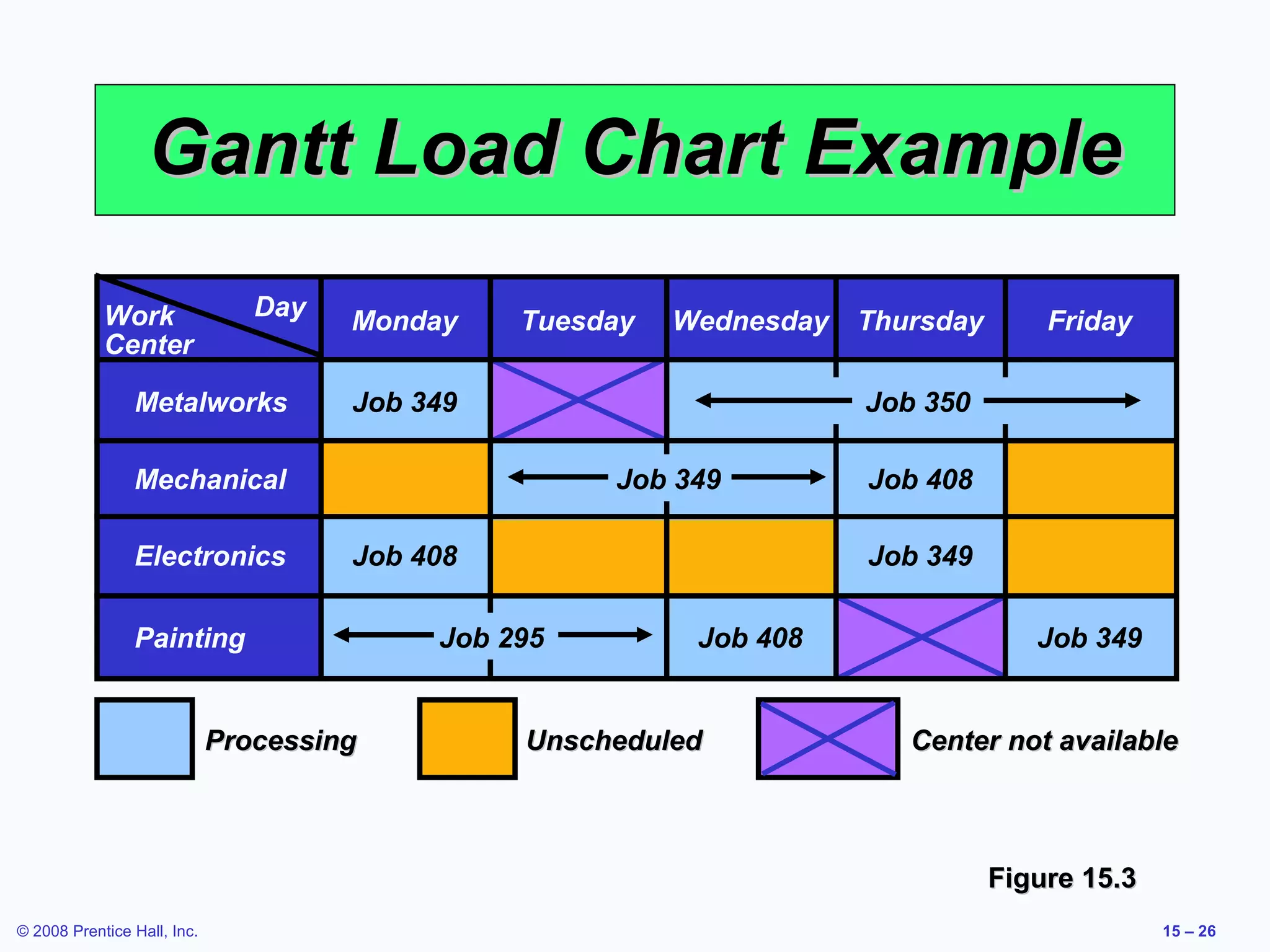

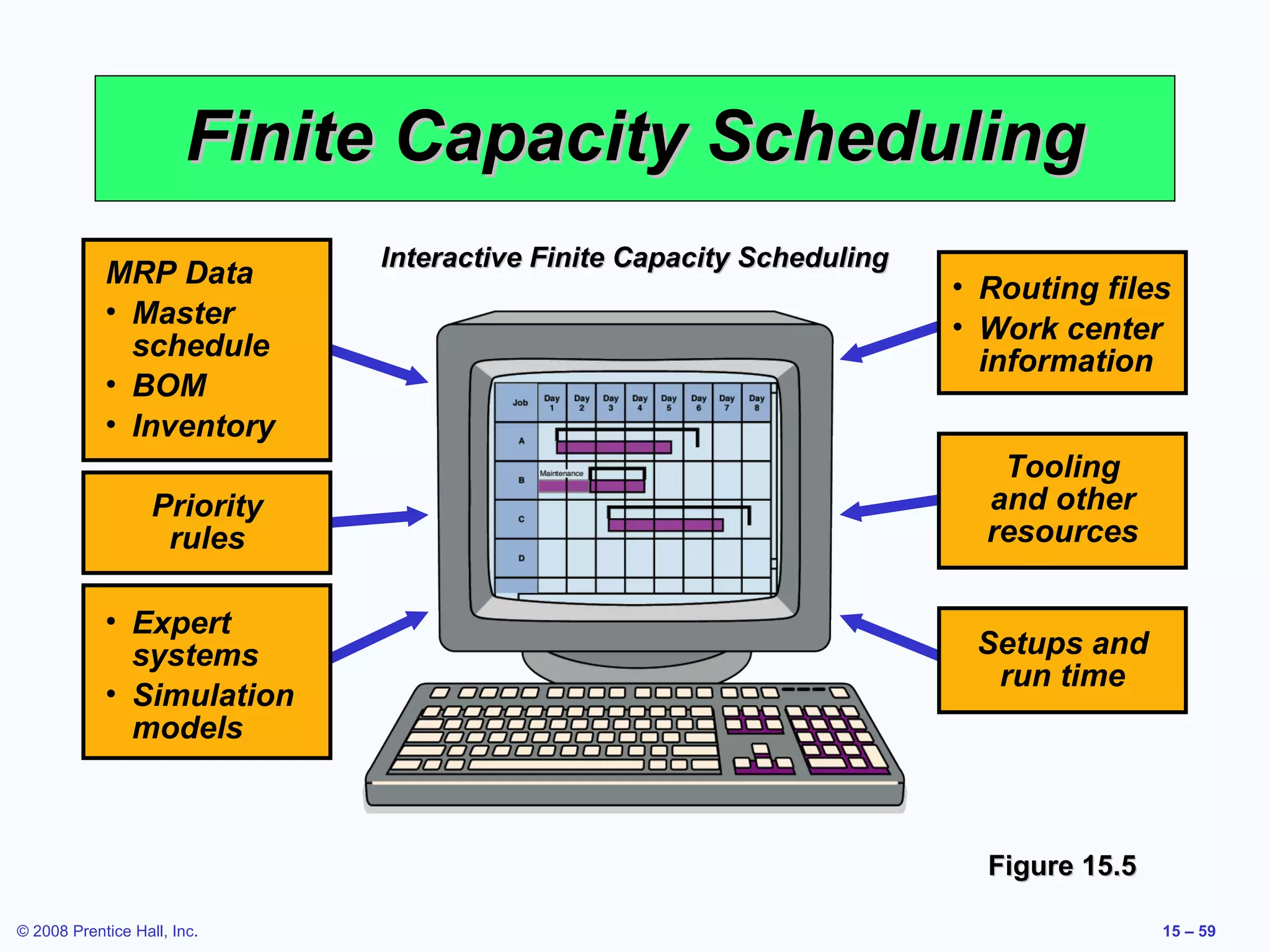

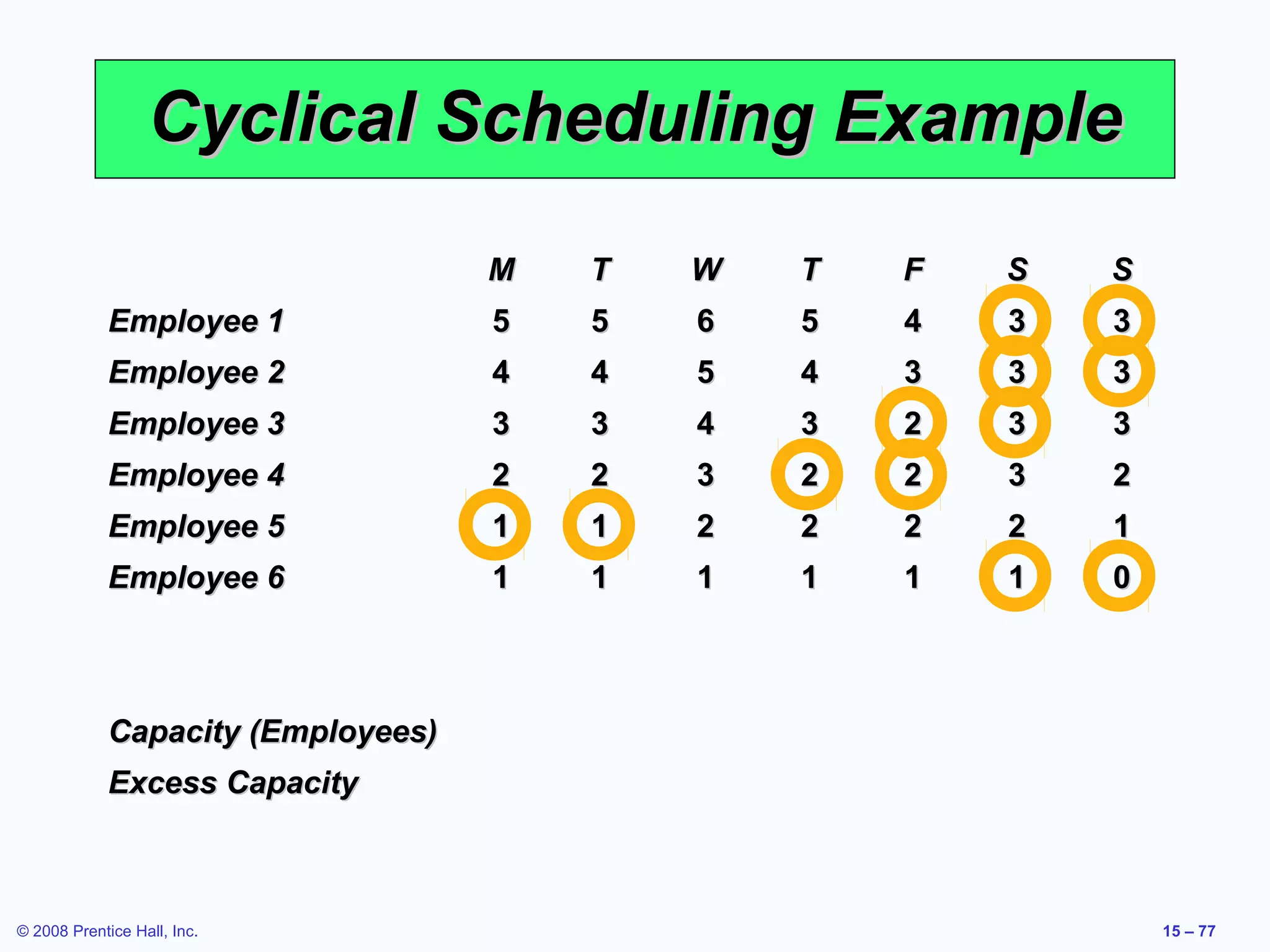

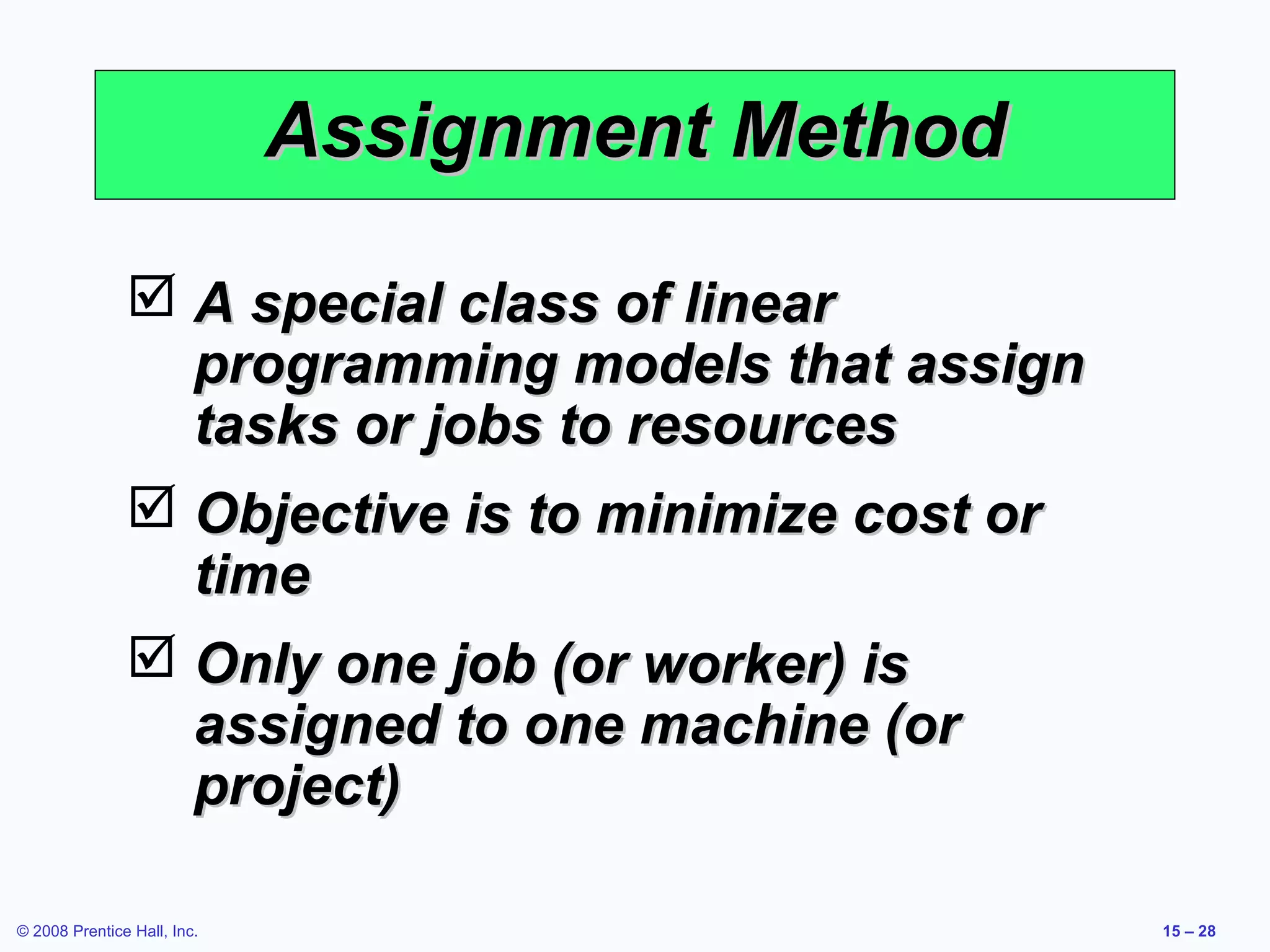

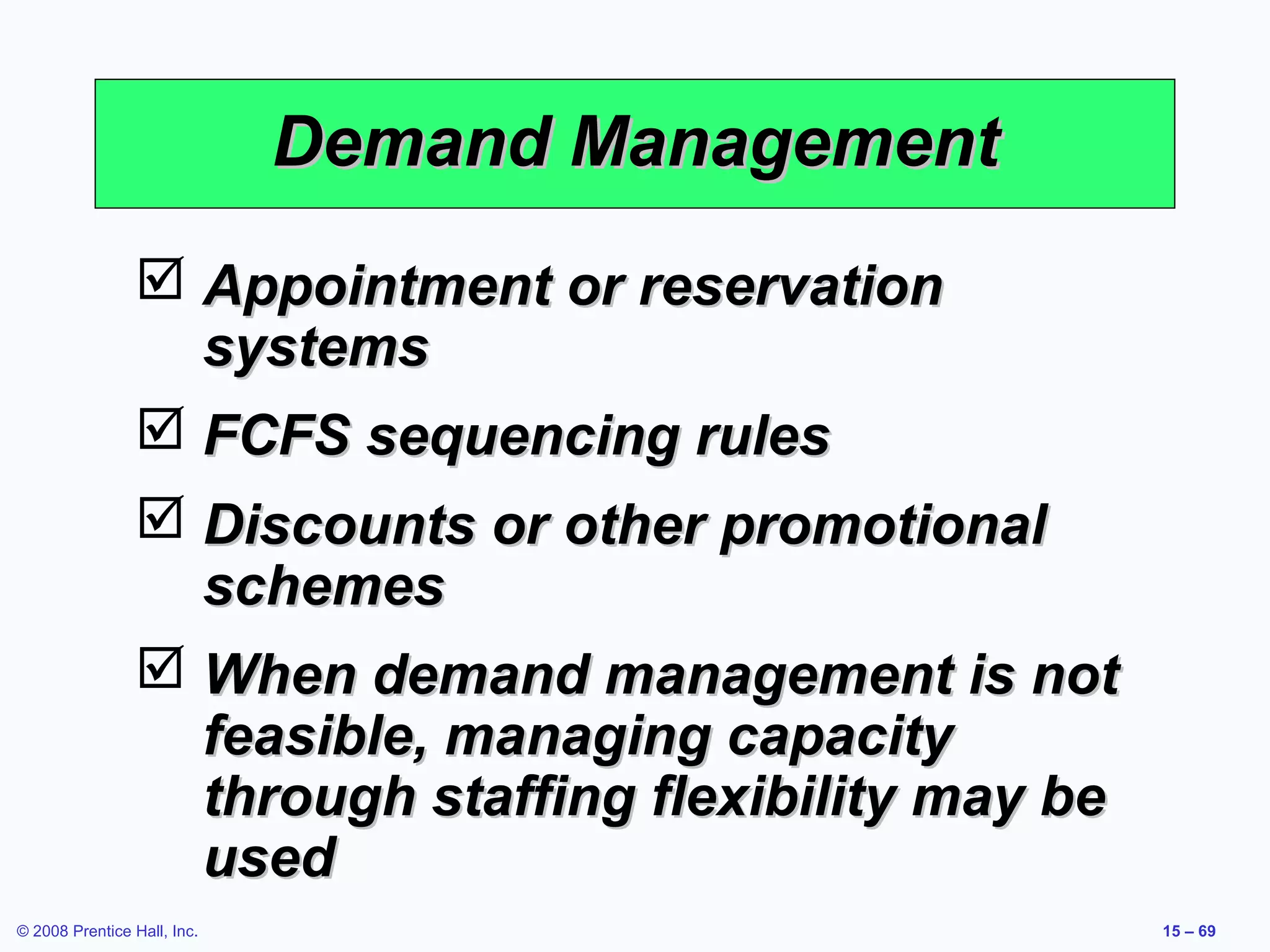

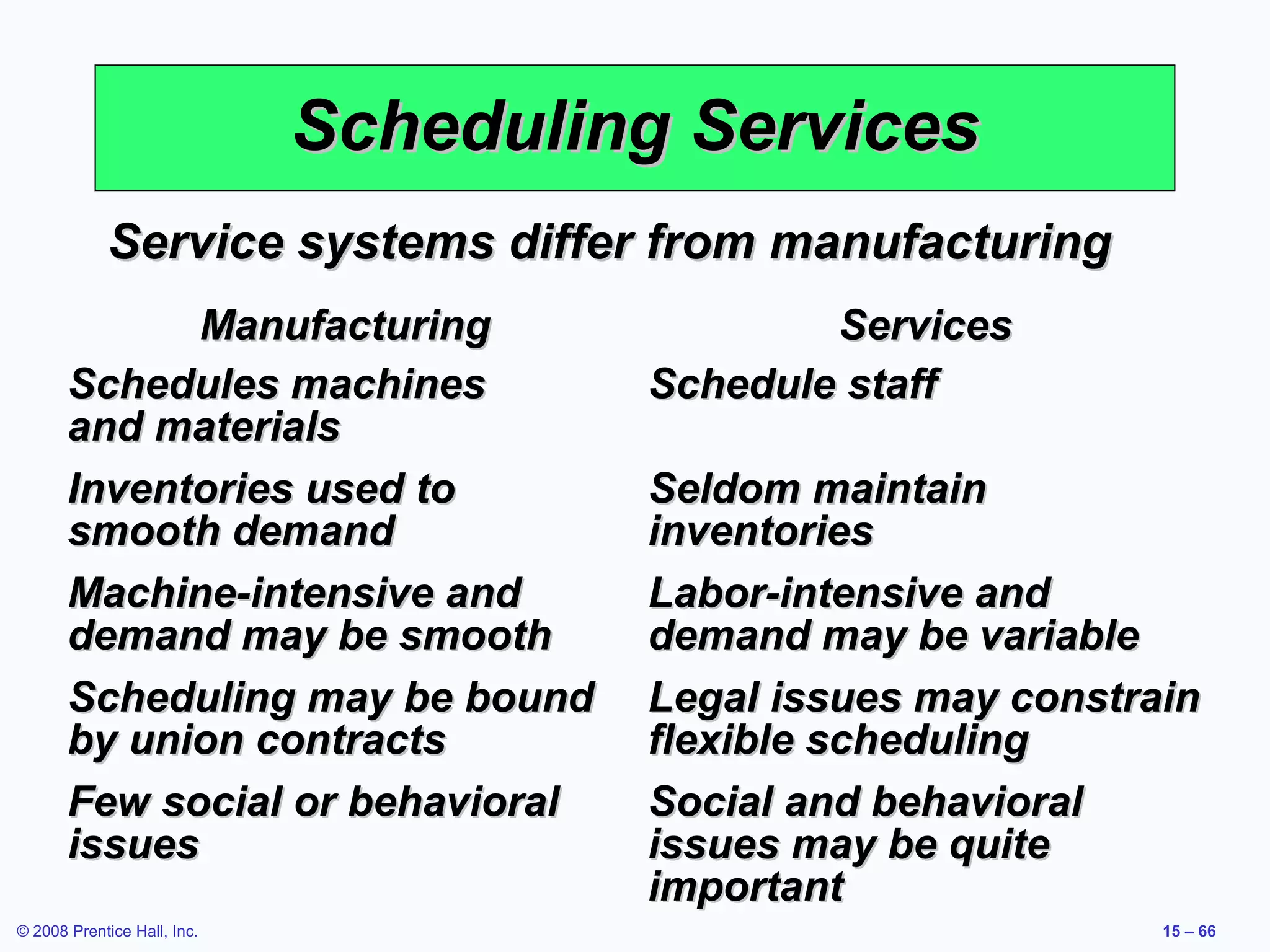

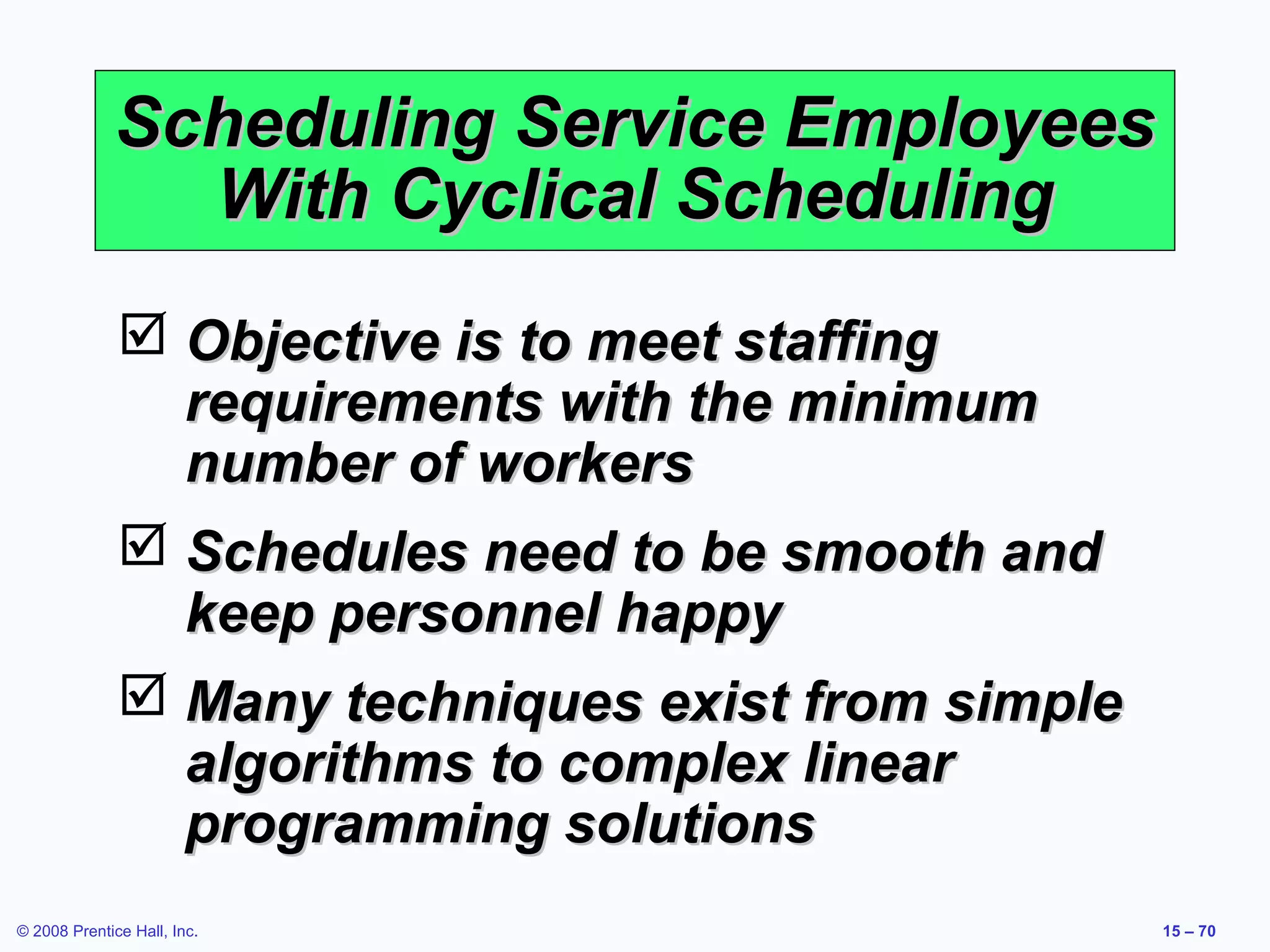

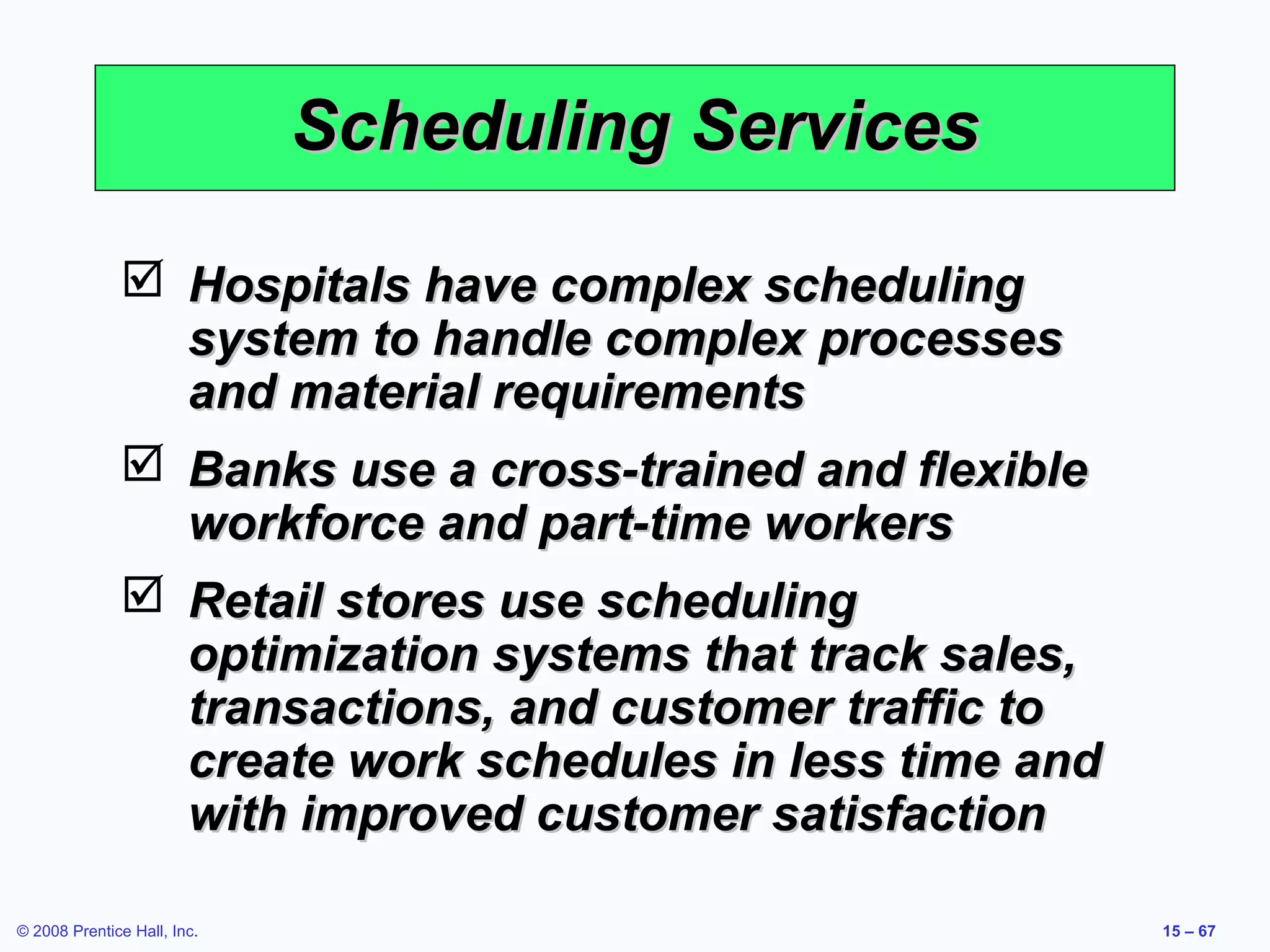

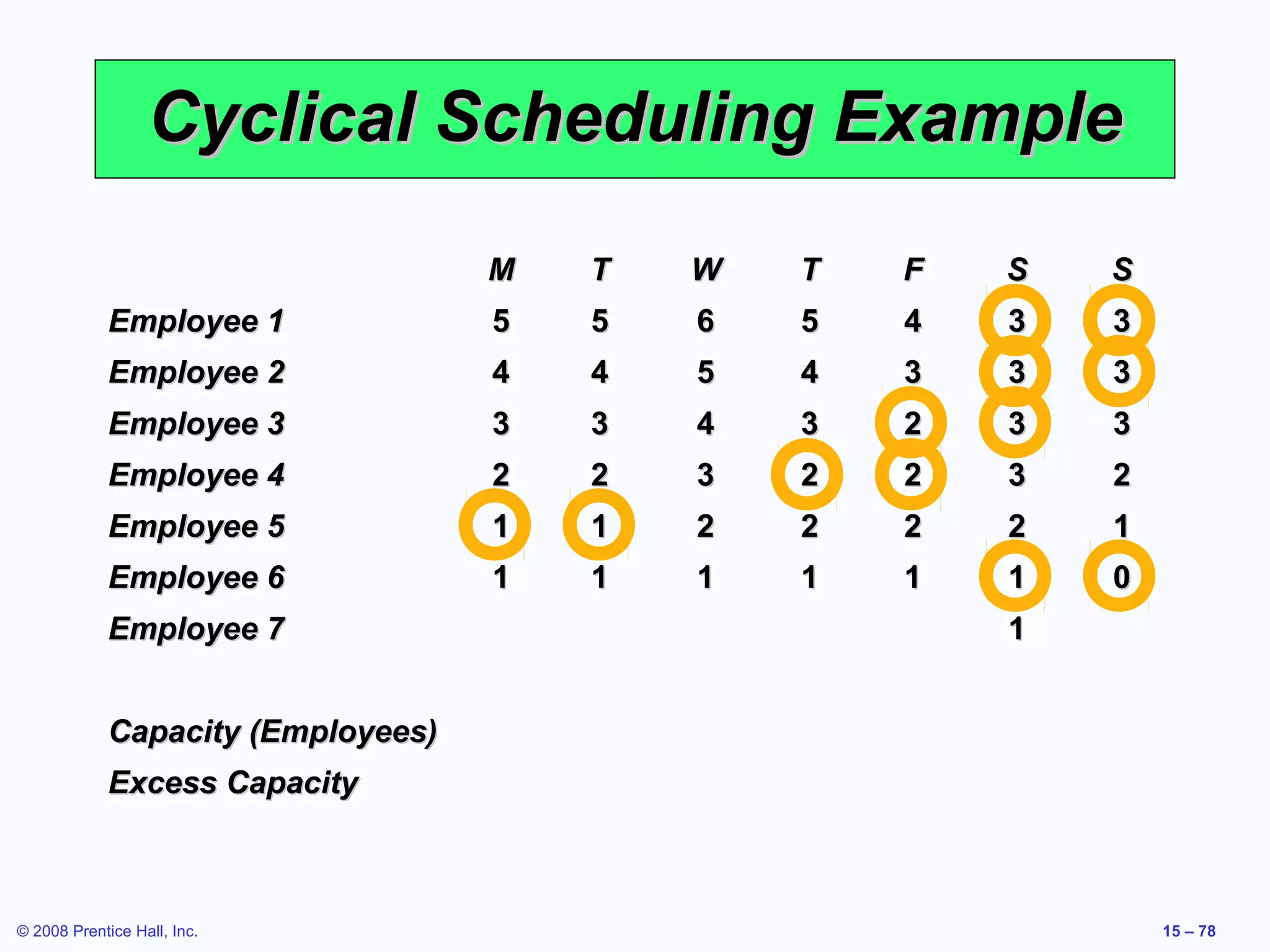

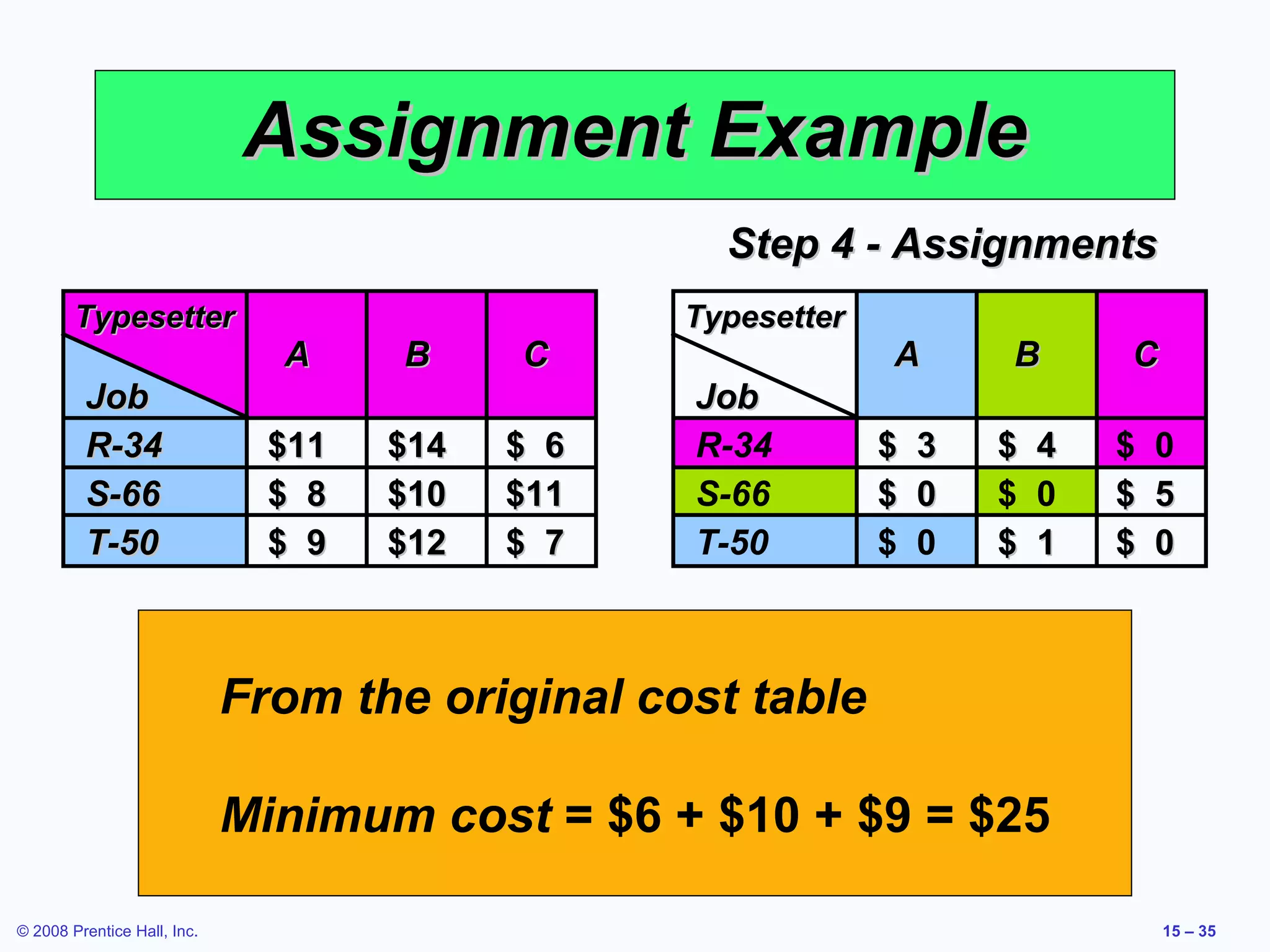

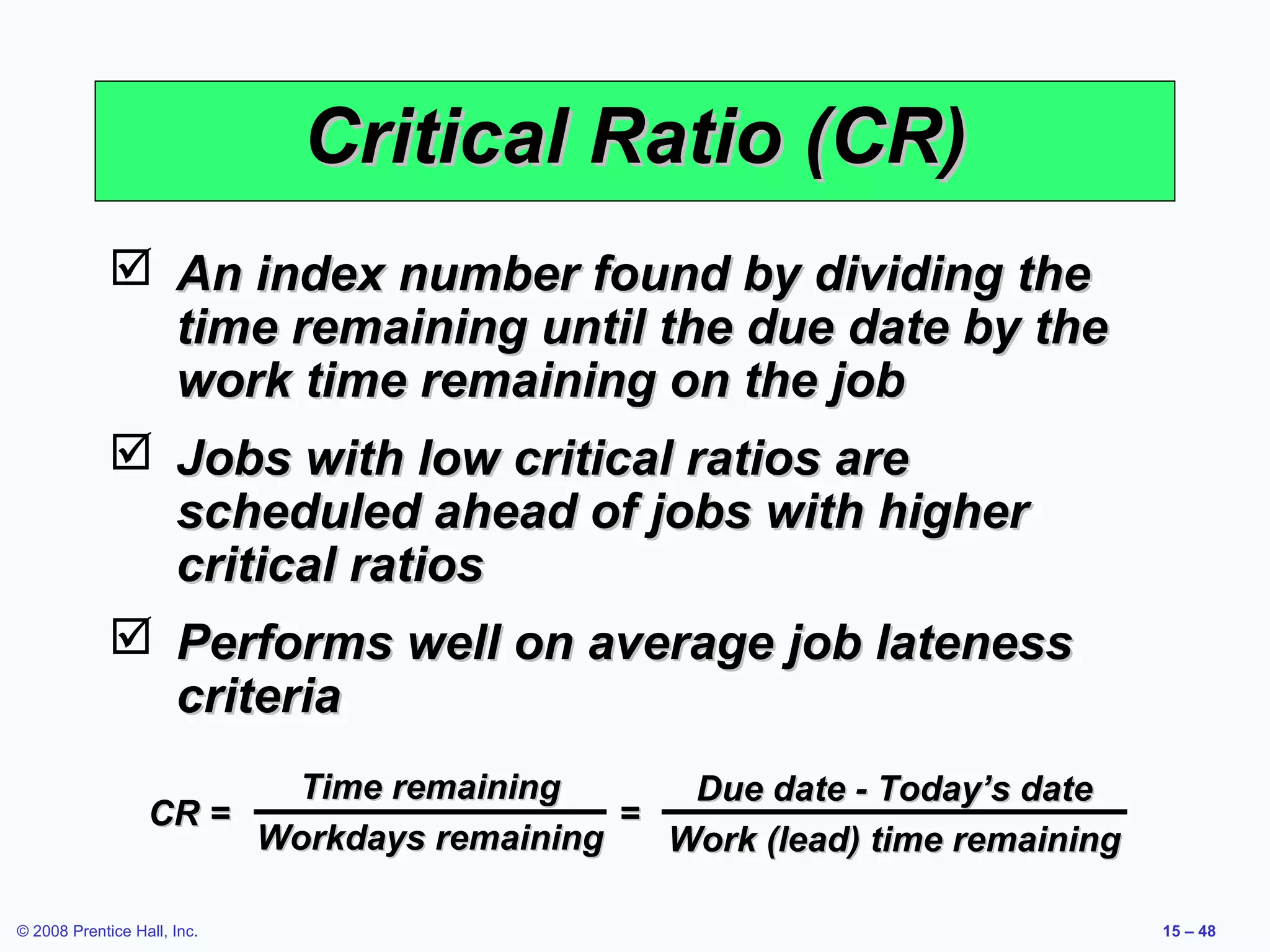

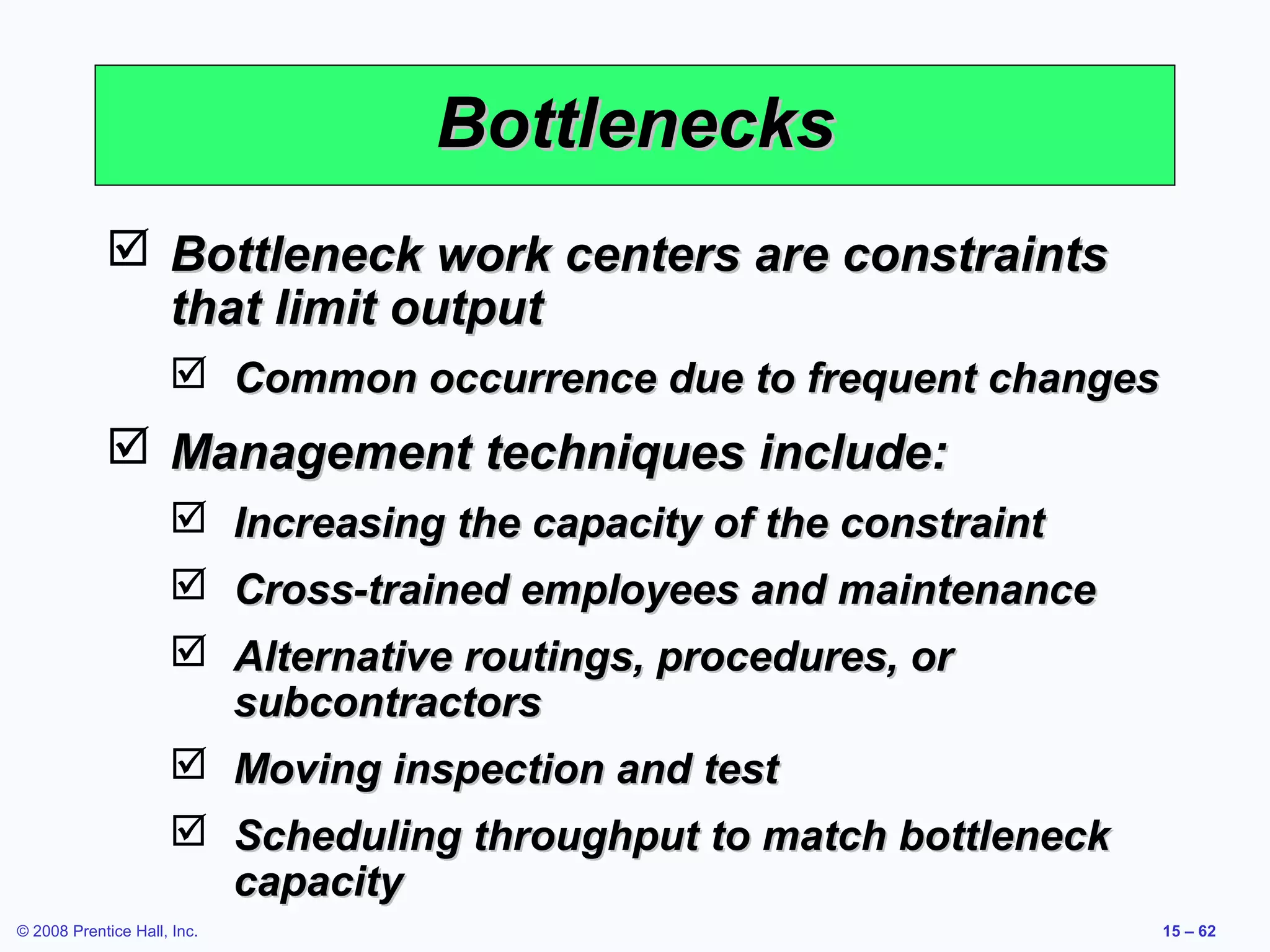

The document outlines the key concepts and methods for short-term scheduling. It discusses scheduling issues like forward versus backward scheduling and scheduling criteria. It also covers scheduling processes for process-focused facilities and the use of tools like input-output control, Gantt charts, and the assignment method to schedule jobs and resources in the short term. The learning objectives focus on explaining short-term scheduling relationships, applying scheduling tools and techniques, and using methods like Johnson's rule and finite capacity scheduling.
