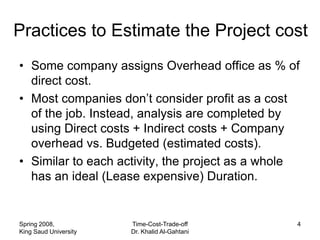

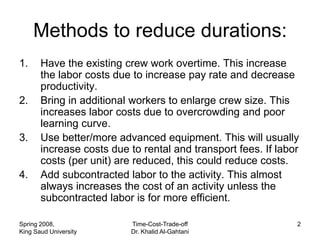

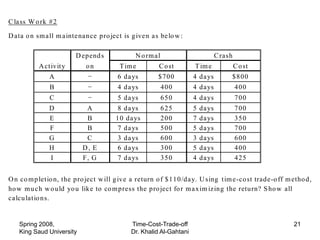

1. The document discusses reasons and methods to reduce project durations, including to earn incentive pay, avoid penalties, and fit contractual timelines. It then describes four common methods: using overtime, adding workers, better equipment, and subcontracting labor.

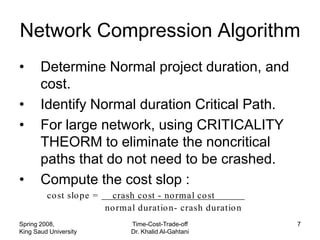

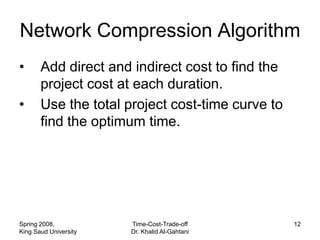

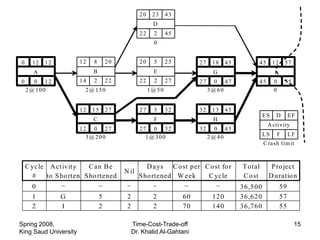

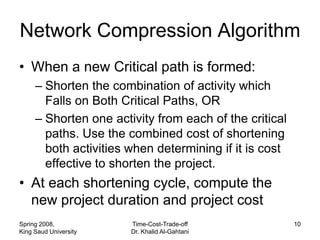

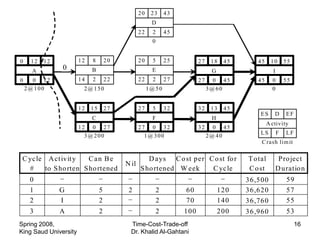

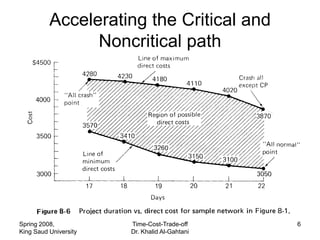

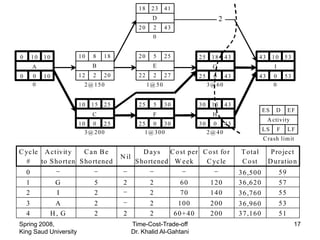

2. The optimal project duration balances minimizing total project costs, including direct costs from activities as well as indirect overhead costs. The network compression algorithm is used to iteratively shorten the critical path by accelerating individual activities until no further reduction is possible without increasing total costs.

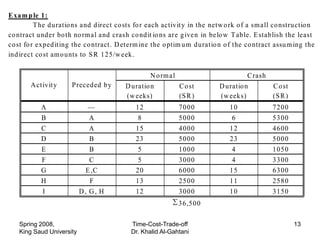

3. An example construction project is provided to demonstrate calculating the least cost project duration using crash costs, indirect costs, and shortening cycles to optimize the project schedule.
