SlideShare a Scribd company logo
1 of 72
Construction Project
Practices
-Arun Kurali
TYPES OF CONTRACT

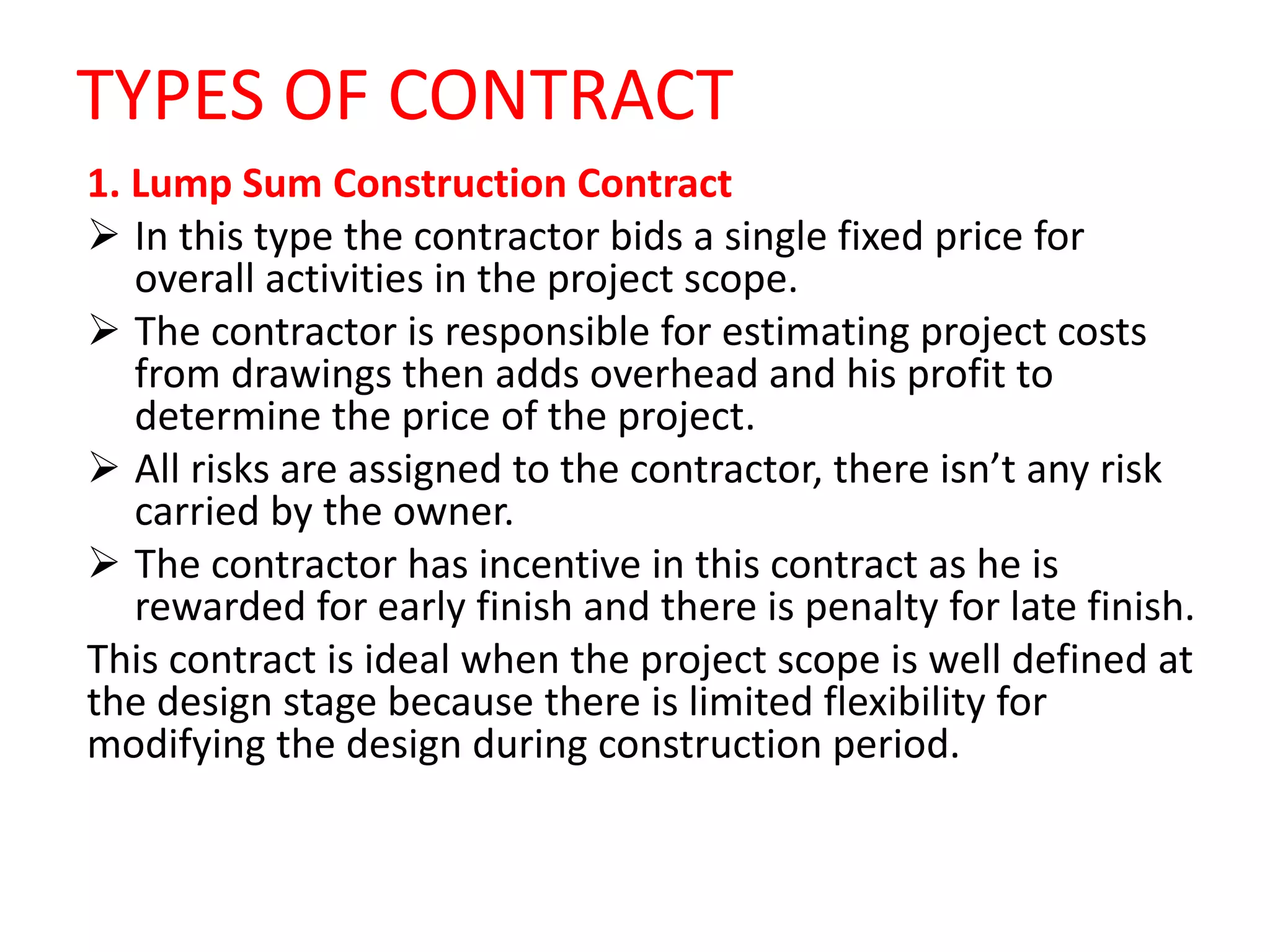

1. Lump Sum Construction Contract
 In this type the contractor bids a single fixed price for
overall activities in the project scope.
 The contractor is responsible for estimating project costs
from drawings then adds overhead and his profit to
determine the price of the project.
 All risks are assigned to the contractor, there isn’t any risk
carried by the owner.
 The contractor has incentive in this contract as he is
rewarded for early finish and there is penalty for late finish.
This contract is ideal when the project scope is well defined at
the design stage because there is limited flexibility for
modifying the design during construction period.

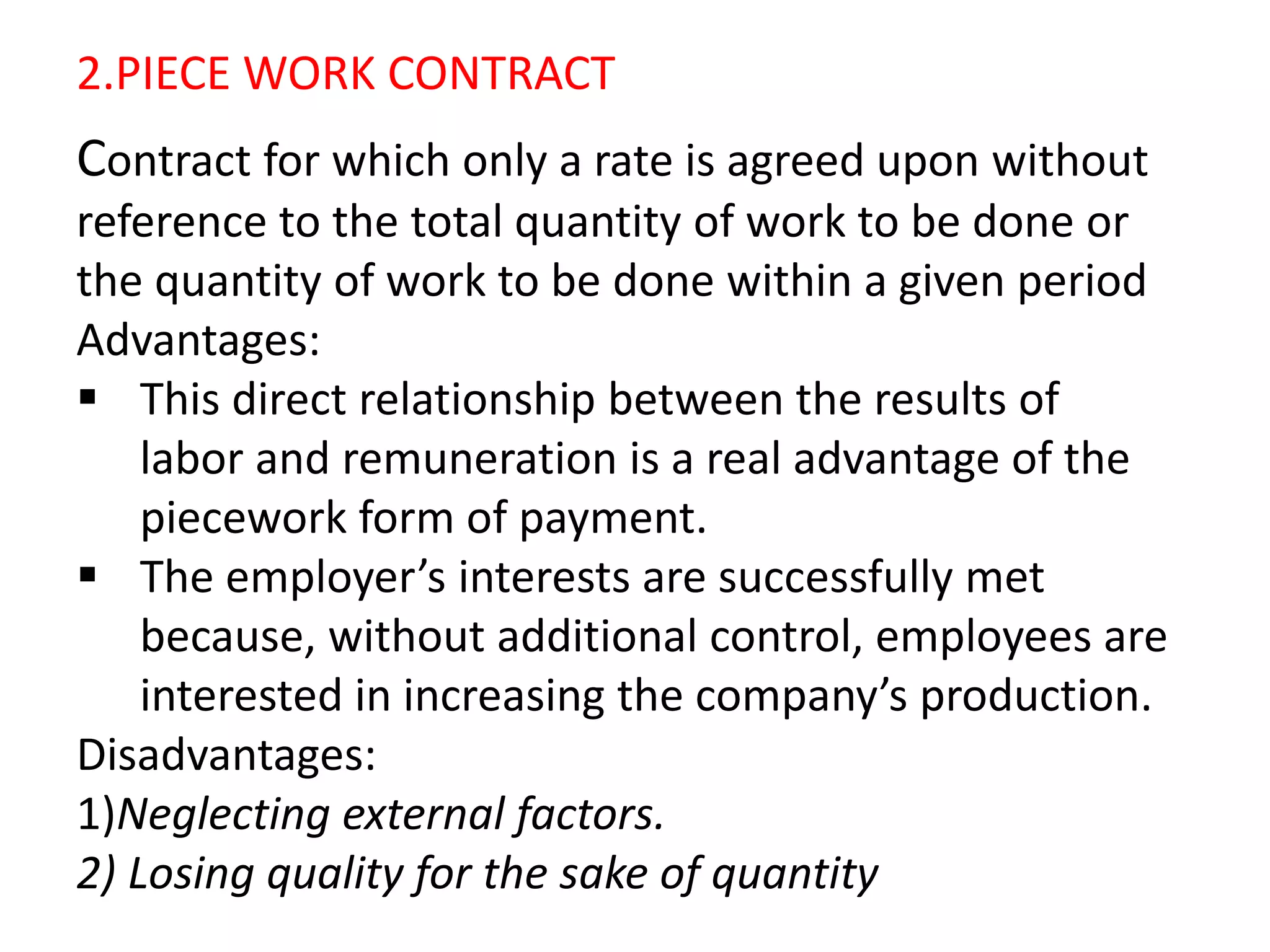

2.PIECE WORK CONTRACT
Contract for which only a rate is agreed upon without
reference to the total quantity of work to be done or
the quantity of work to be done within a given period
Advantages:
 This direct relationship between the results of
labor and remuneration is a real advantage of the
piecework form of payment.
 The employer’s interests are successfully met
because, without additional control, employees are
interested in increasing the company’s production.
Disadvantages:
1)Neglecting external factors.
2) Losing quality for the sake of quantity

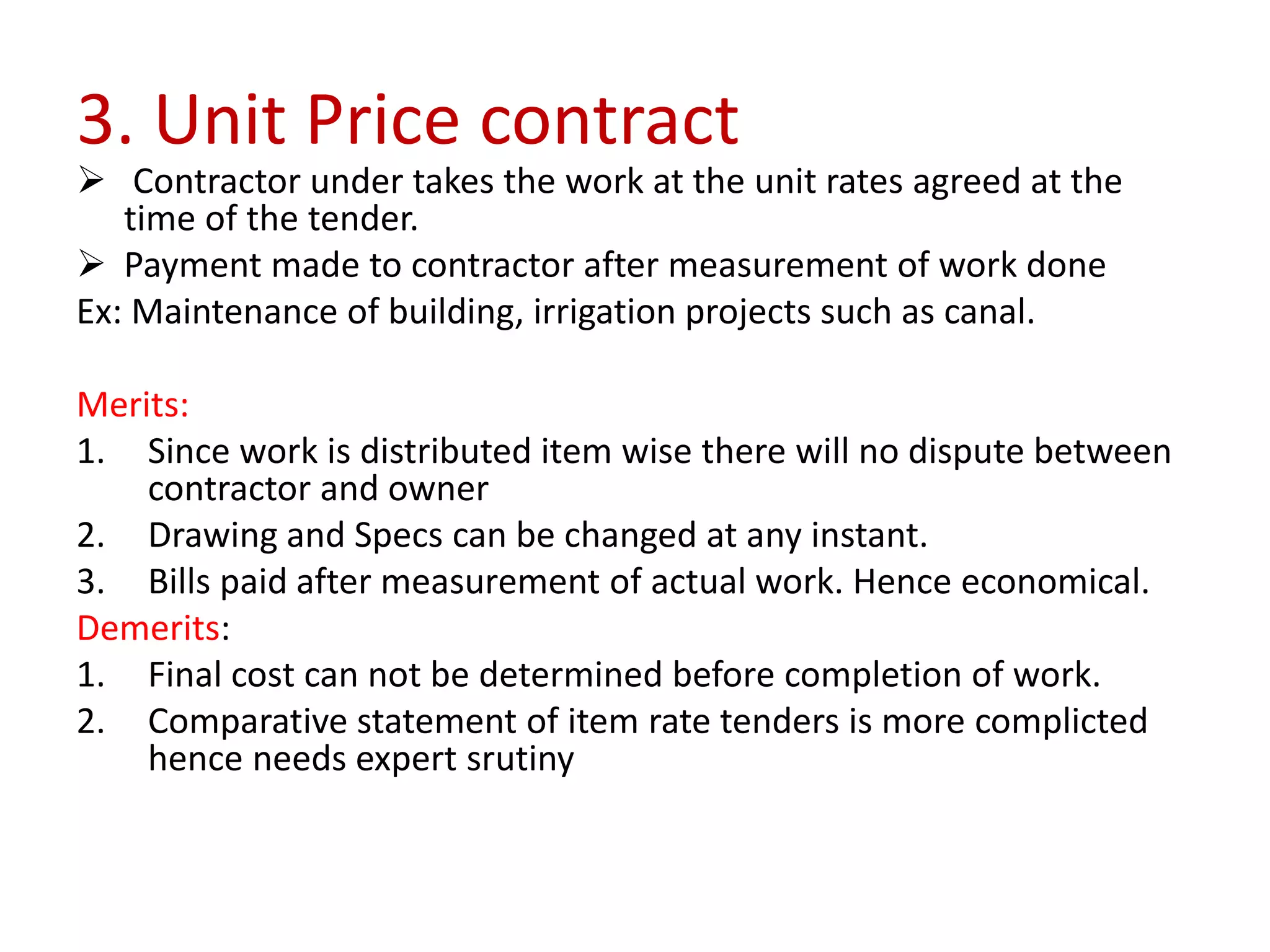

3. Unit Price contract
 Contractor under takes the work at the unit rates agreed at the
time of the tender.
 Payment made to contractor after measurement of work done
Ex: Maintenance of building, irrigation projects such as canal.
Merits:
1. Since work is distributed item wise there will no dispute between
contractor and owner
2. Drawing and Specs can be changed at any instant.
3. Bills paid after measurement of actual work. Hence economical.
Demerits:
1. Final cost can not be determined before completion of work.
2. Comparative statement of item rate tenders is more complicted
hence needs expert srutiny

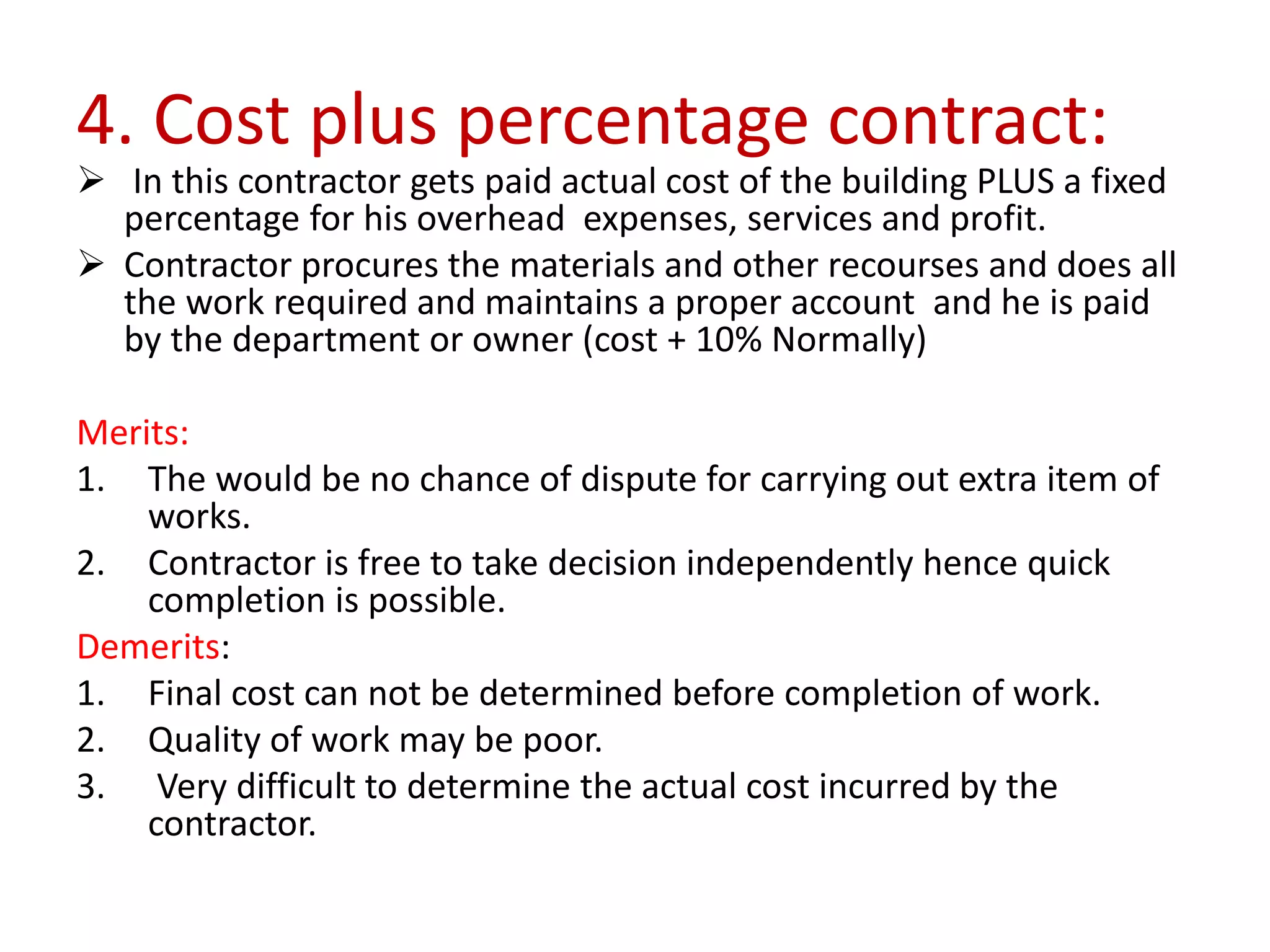

4. Cost plus percentage contract:
 In this contractor gets paid actual cost of the building PLUS a fixed
percentage for his overhead expenses, services and profit.
 Contractor procures the materials and other recourses and does all
the work required and maintains a proper account and he is paid
by the department or owner (cost + 10% Normally)
Merits:
1. The would be no chance of dispute for carrying out extra item of
works.
2. Contractor is free to take decision independently hence quick
completion is possible.
Demerits:
1. Final cost can not be determined before completion of work.
2. Quality of work may be poor.
3. Very difficult to determine the actual cost incurred by the
contractor.

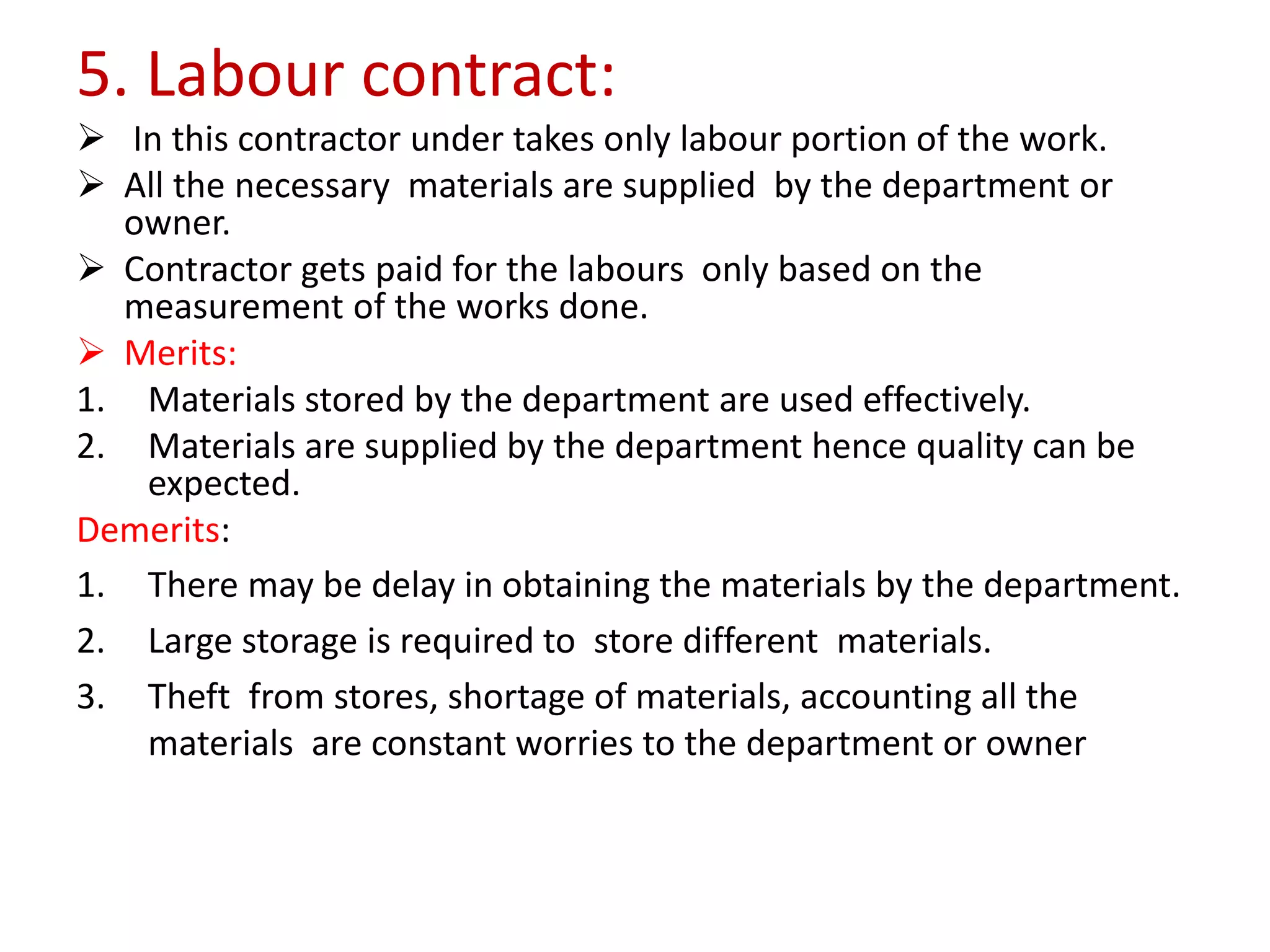

5. Labour contract:
 In this contractor under takes only labour portion of the work.
 All the necessary materials are supplied by the department or
owner.
 Contractor gets paid for the labours only based on the
measurement of the works done.
 Merits:
1. Materials stored by the department are used effectively.
2. Materials are supplied by the department hence quality can be
expected.
Demerits:
1. There may be delay in obtaining the materials by the department.
2. Large storage is required to store different materials.
3. Theft from stores, shortage of materials, accounting all the
materials are constant worries to the department or owner

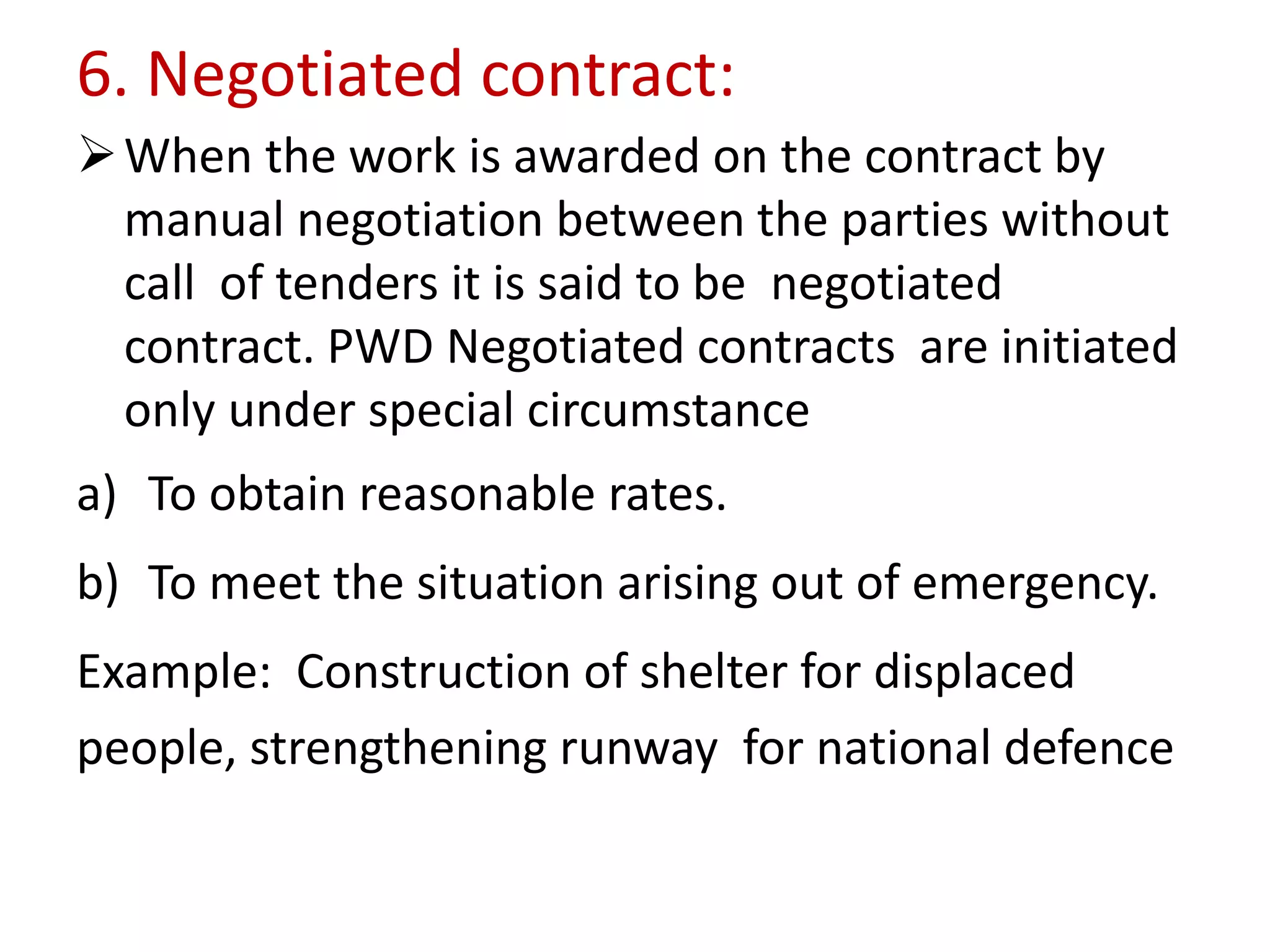

6. Negotiated contract:
When the work is awarded on the contract by
manual negotiation between the parties without
call of tenders it is said to be negotiated
contract. PWD Negotiated contracts are initiated
only under special circumstance
a) To obtain reasonable rates.
b) To meet the situation arising out of emergency.
Example: Construction of shelter for displaced
people, strengthening runway for national defence
Point of Differentiation Lump Sum Contract
Unit
Price Contract
Cost
Plus Contract
Piece
work Contract
Advantages with respect to
the contractor
Incentives for early finish Low risk No risk
Rewards for any
savings between
actual and target
cost
Disadvantages with respect
to the contractor
High risk
No incentives for
early finish
No incentives for
early finish
Share risk with
the owner
Advantages with respect to
the owner
No risk
Share risk with the
contractor
Can start project
without finishing
designs
Target cost is
defined at early
stagesTotal cost is defined at early
stages
Disadvantages with respect
to the owner
Contractor desire to
decrease costs may be to
detriment of quality
Total cost is
uncertain at early
stages
High risk
Share risk with
the contractor
Total cost is
uncertain at early
stages
Flexibility of design
changing
Limited flexibility
Has flexibility to
change design
More flexible to
design stages
Limited flexibility

General Condition of contract:
1. The rates agreed by the contractor should be inclusive of
transport,materials,labours,tools,plants and all other
necessary arrangements.
2. The contractor should deposit 10% of the cost of the work
as a security deposit the contractor may deposit the entire
amount at the beginning of the project or can be deducted
from the running bills contractor
3. The contractor should complete the work within specified
time otherwise he is liable for the penalty
4. The time may be extended by the department for the valid
reasons requested by the contractor
5. The cost of the material issued to the contractor
equipment given to the contractor shall be deducted from his
running bills

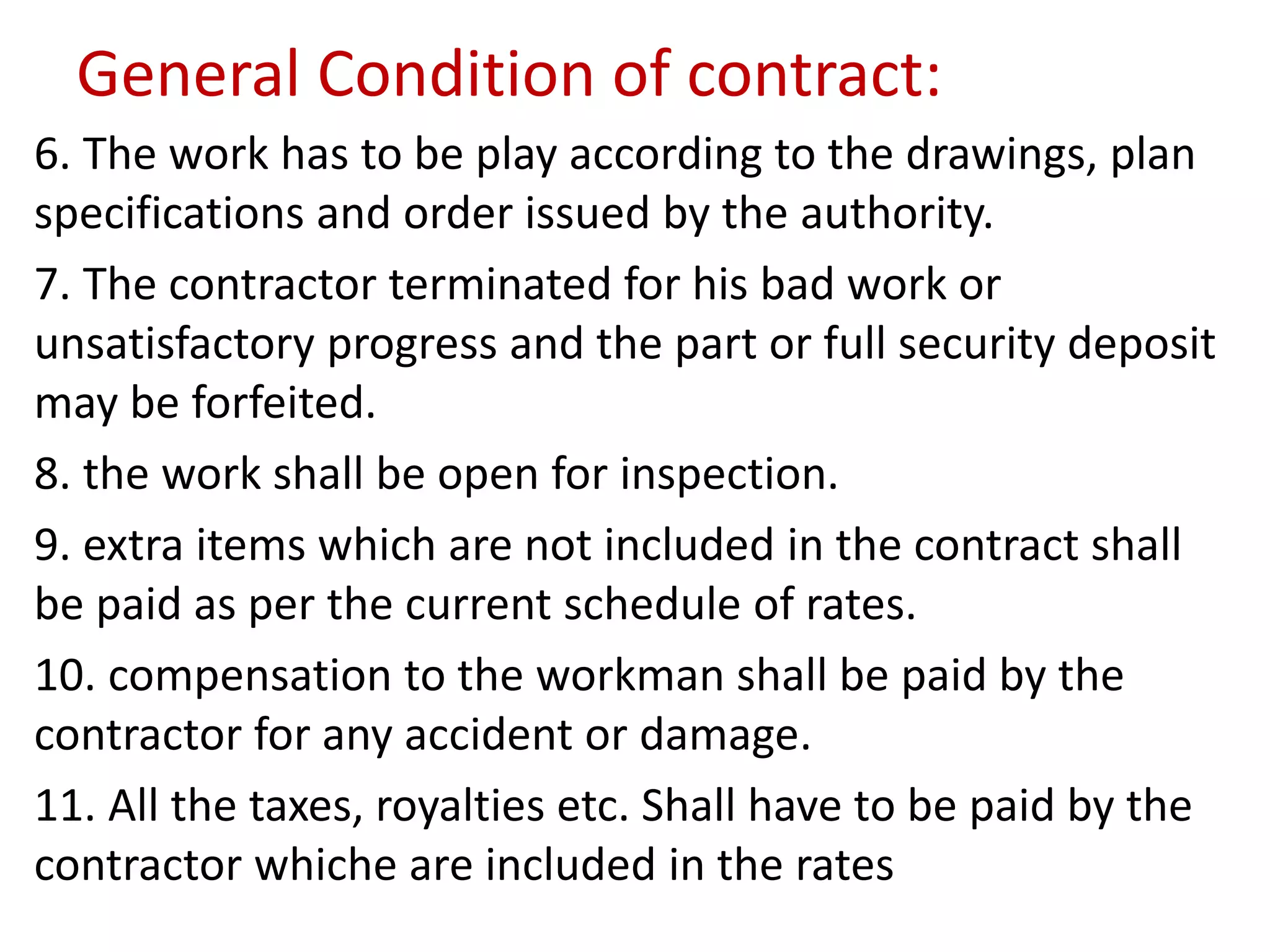

General Condition of contract:
6. The work has to be play according to the drawings, plan
specifications and order issued by the authority.
7. The contractor terminated for his bad work or
unsatisfactory progress and the part or full security deposit
may be forfeited.
8. the work shall be open for inspection.
9. extra items which are not included in the contract shall
be paid as per the current schedule of rates.
10. compensation to the workman shall be paid by the
contractor for any accident or damage.
11. All the taxes, royalties etc. Shall have to be paid by the
contractor whiche are included in the rates
Contract Agreement:
Contract agreement is written document binding legally the
contractor and the department to follow the rules and
regulations.
All the pages of the agreement must be signed by both
parties.
Contract agreement must be containing following details.
1) Title page with name of the work and contract number.
2)Index page giving the content of the agreement the page
preferences
3) tender notice with description of work, location time,
period of completion etc
Contract Agreement (continued…):
4) bill of quantities and total cost of the work etc
5) schedule of issue of materials giving list of materials to be issued
with rate and place of issue
6) general specification during the classes and type of work.
7) detailed specification for the each item of work and materials.
8) complete Drawings with plan, elevation, site plan and other relevant
details.
9) condition of contract giving rate of labour, materials, tools and
plants, progress rate etc.
10) special conditions regarding nature of work, taxes, royalties, labour
and amenities etc
Contract Agreement:
Tender:
Tender is an offer in writing to execute some
specified work or to supply the materials at certain
prices within a fixed time under the certain
conditions of agreement between the contractor
and the owner
Necessity of tenders:
1. Lower bids may be obtained due to competition.
2. Contractors experience can be utilised.
3. Partiality, Personal interest,Prejudices,can be
avoided

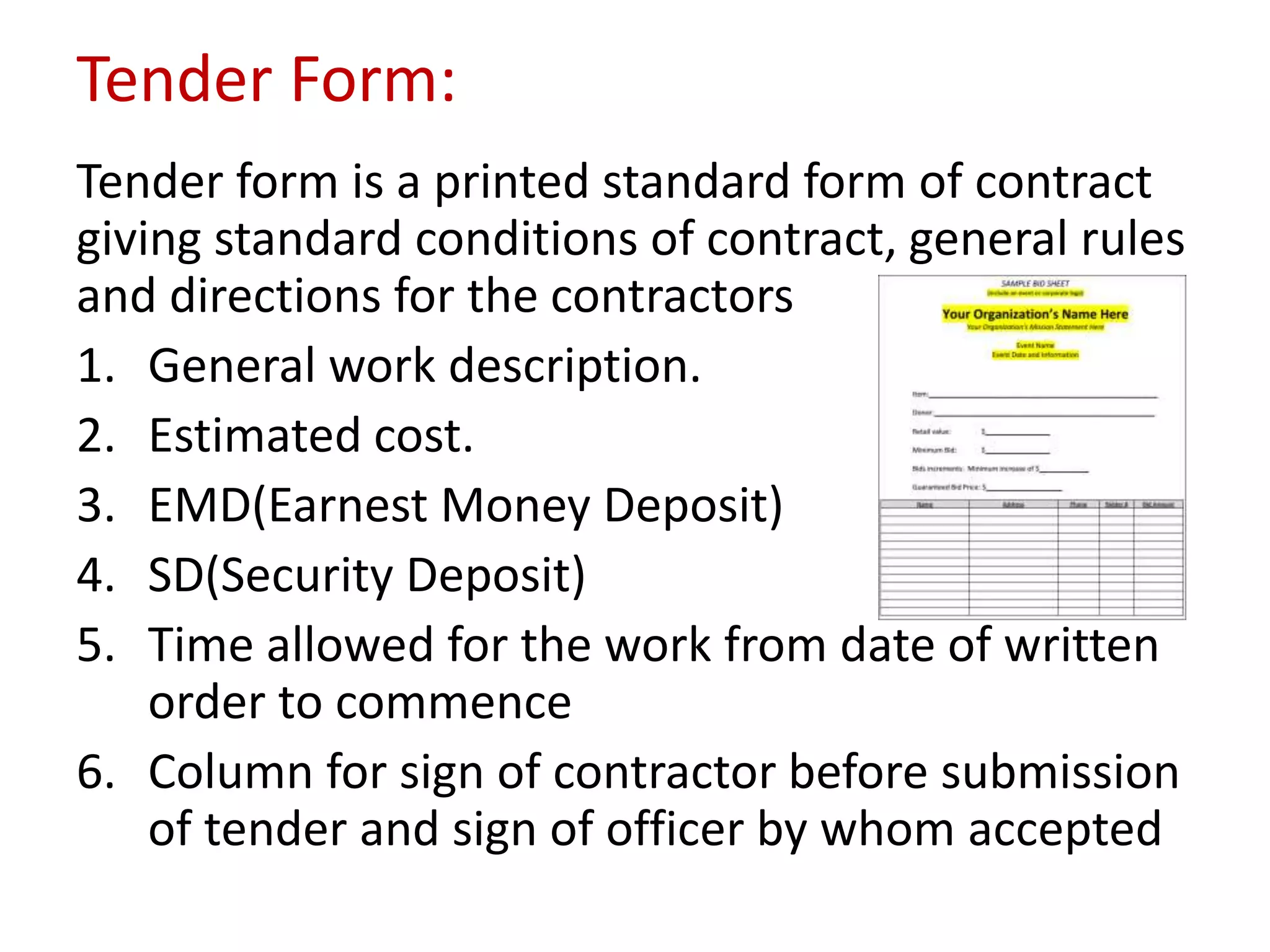

Tender Form:
Tender form is a printed standard form of contract
giving standard conditions of contract, general rules
and directions for the contractors
1. General work description.
2. Estimated cost.
3. EMD(Earnest Money Deposit)
4. SD(Security Deposit)
5. Time allowed for the work from date of written
order to commence
6. Column for sign of contractor before submission
of tender and sign of officer by whom accepted

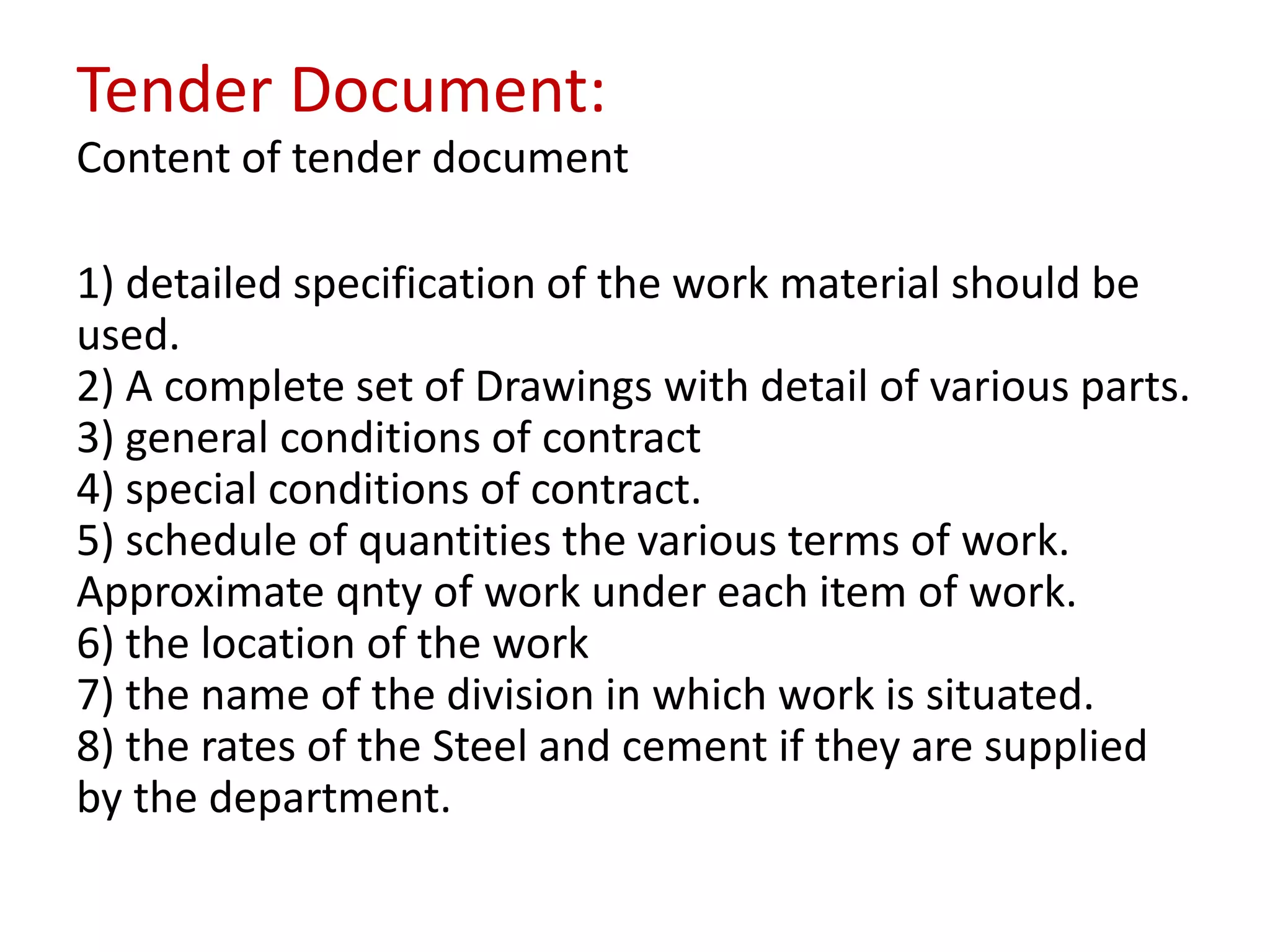

Tender Document:
Content of tender document
1) detailed specification of the work material should be
used.
2) A complete set of Drawings with detail of various parts.
3) general conditions of contract
4) special conditions of contract.
5) schedule of quantities the various terms of work.
Approximate qnty of work under each item of work.
6) the location of the work
7) the name of the division in which work is situated.
8) the rates of the Steel and cement if they are supplied
by the department.
Tender Document:

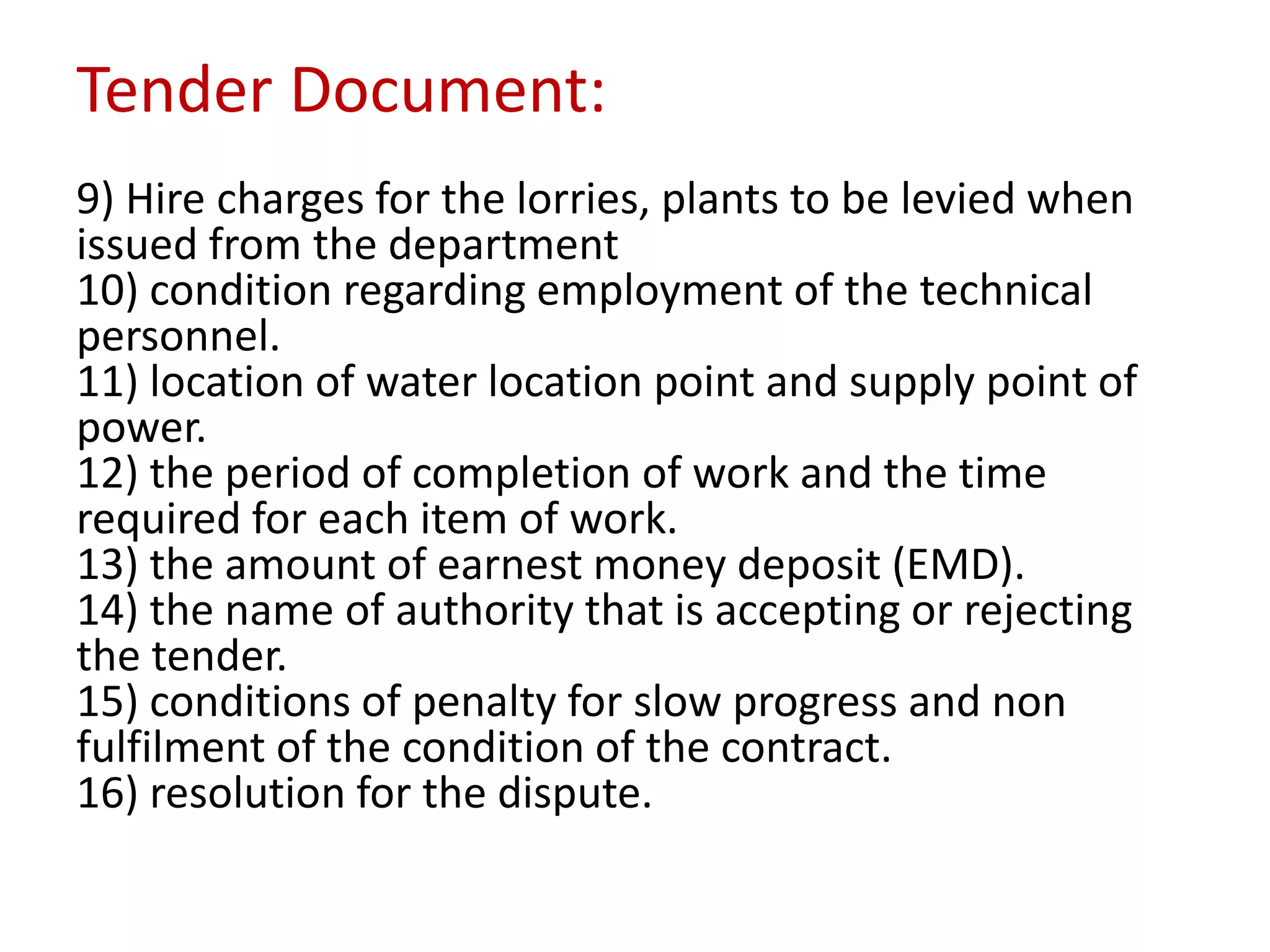

9) Hire charges for the lorries, plants to be levied when
issued from the department
10) condition regarding employment of the technical
personnel.
11) location of water location point and supply point of
power.
12) the period of completion of work and the time
required for each item of work.
13) the amount of earnest money deposit (EMD).
14) the name of authority that is accepting or rejecting
the tender.
15) conditions of penalty for slow progress and non
fulfilment of the condition of the contract.
16) resolution for the dispute.
Tender Notice:
After approval of tender
document by the concern
authority inviting tender has
to be published on the
notice board and all units
of the department and
advertisement in the press
and by the notice in English/
Hindi newspapers.
Following particulars should be written in the
tender notice:
1) name of the authority inviting the tender.
2) name of the work and it's location.
3) estimated cost of the work.
4) period and type of contract.
5) when and where the tender document should be
purchased.
6) tender schedule.
7) the amount of EMD and SD
8) open timing of the tender opening.
9) designation of the officer who accepts the
tender.
Preparing comparative statement of tender
Once after the tender opens comparative
statements should be prepared it serves the
rates of different builders normally lowest will
be a successful bidder hands become the
contractor

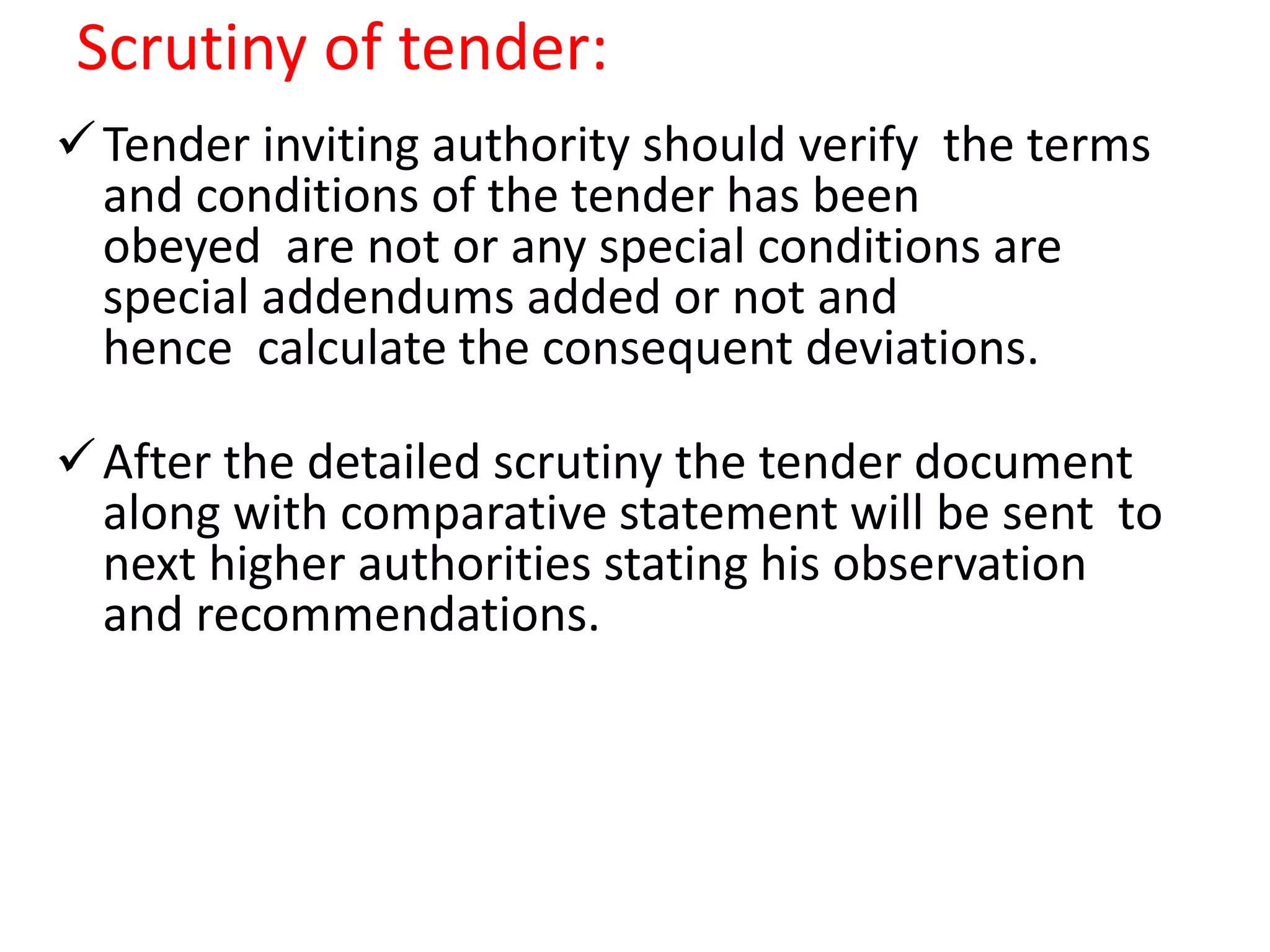

Scrutiny of tender:
Tender inviting authority should verify the terms
and conditions of the tender has been
obeyed are not or any special conditions are
special addendums added or not and
hence calculate the consequent deviations.
After the detailed scrutiny the tender document
along with comparative statement will be sent to
next higher authorities stating his observation
and recommendations.

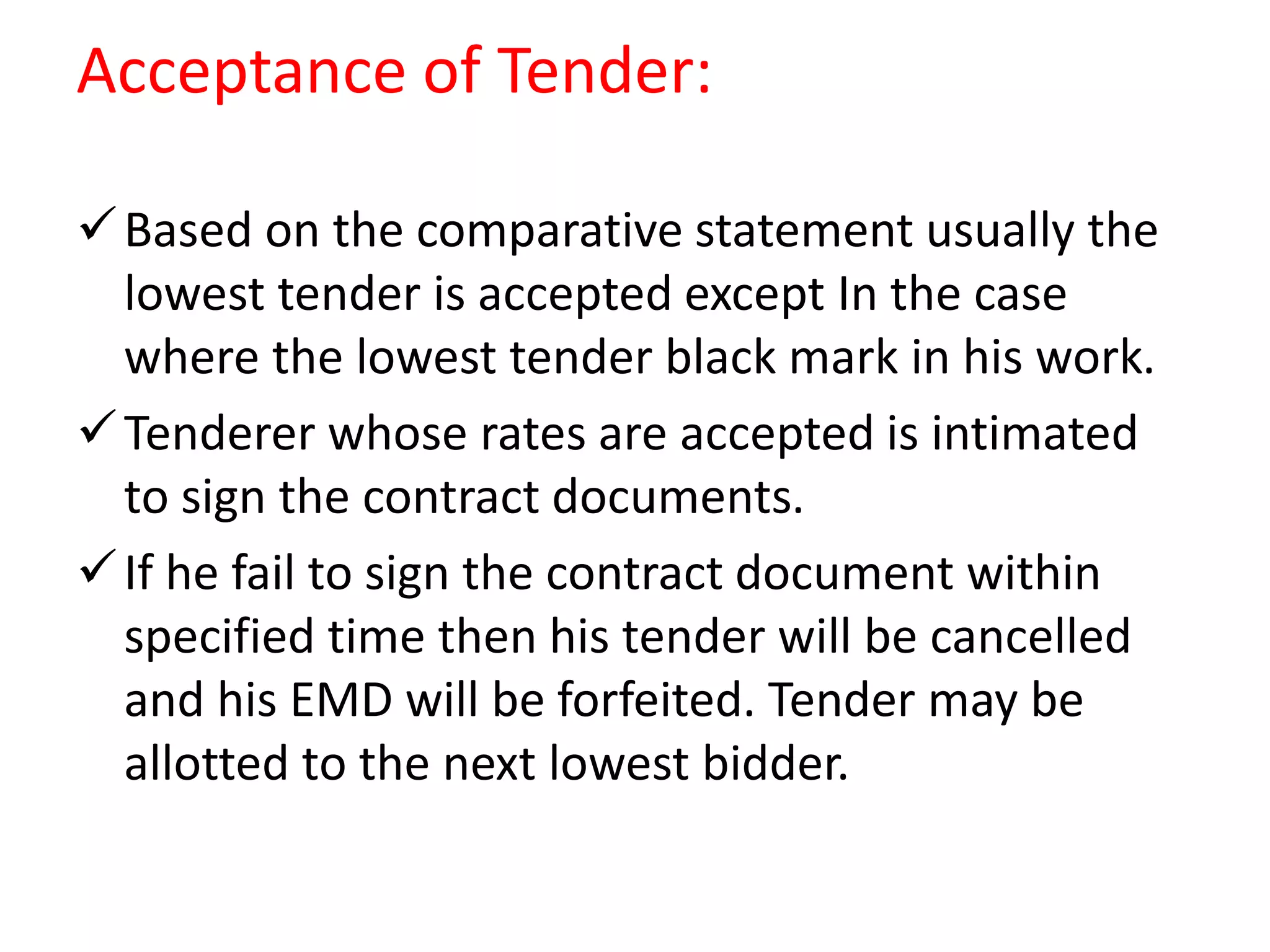

Acceptance of Tender:
Based on the comparative statement usually the
lowest tender is accepted except In the case
where the lowest tender black mark in his work.
Tenderer whose rates are accepted is intimated
to sign the contract documents.
If he fail to sign the contract document within
specified time then his tender will be cancelled
and his EMD will be forfeited. Tender may be
allotted to the next lowest bidder.
Execution of contract agreement:
After acceptance of tender and contract
documents. contractor required to pay security
deposit before contract agreement is signed.
Earnest money deposit(EMD):
when the contractor submits the tender to any
work, he have to deposit some amount usually
2% of the estimated cost to the department as
the guarantee of tender.
When contractor refuses to take work after the
acceptance of tender then the EMD will be
forfeited. But EMD of all other Unsuccessful
bidders will be returned.

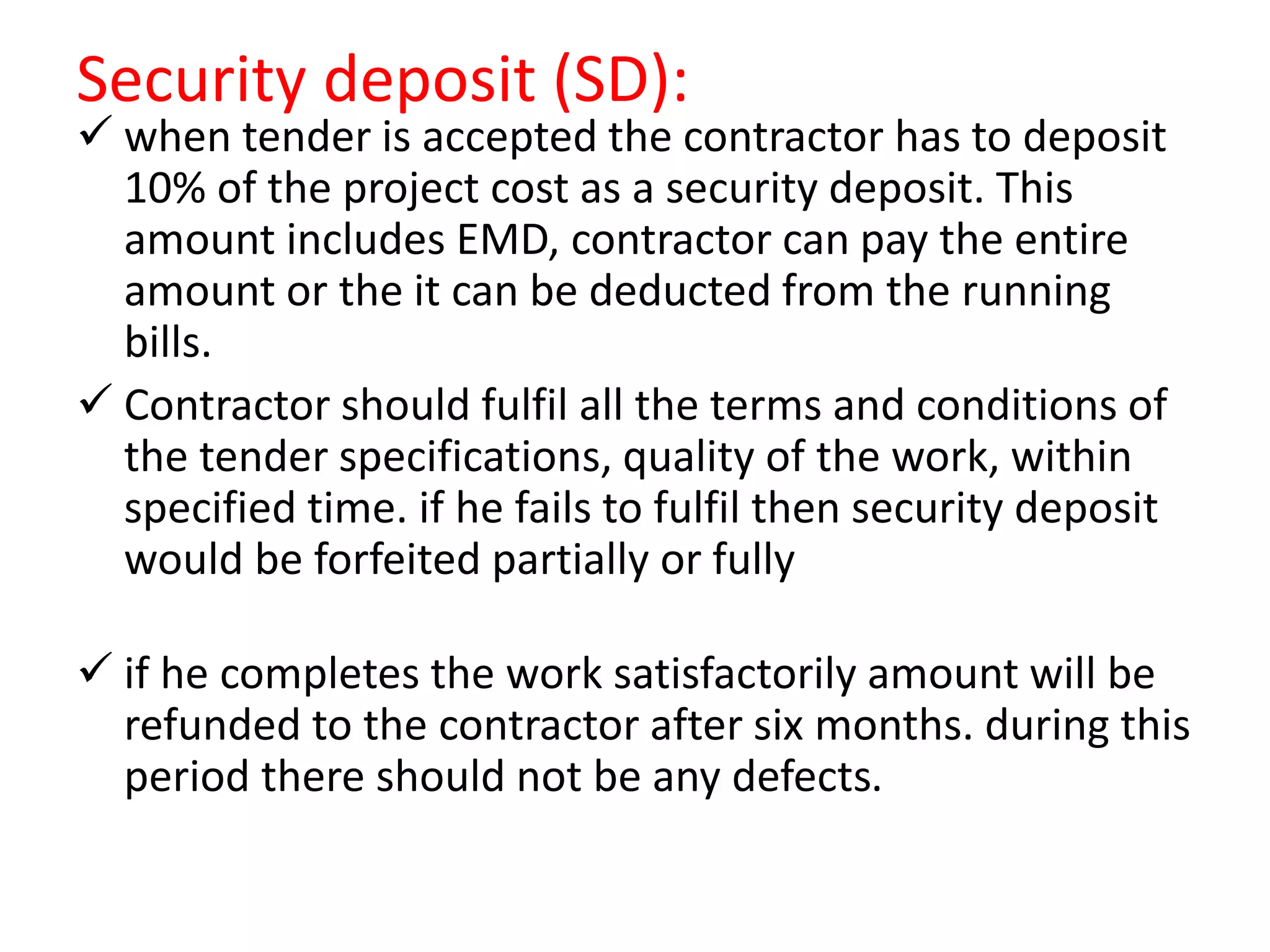

Security deposit (SD):
 when tender is accepted the contractor has to deposit
10% of the project cost as a security deposit. This
amount includes EMD, contractor can pay the entire
amount or the it can be deducted from the running
bills.
 Contractor should fulfil all the terms and conditions of
the tender specifications, quality of the work, within
specified time. if he fails to fulfil then security deposit
would be forfeited partially or fully
 if he completes the work satisfactorily amount will be
refunded to the contractor after six months. during this
period there should not be any defects.
work order: for petty and small works
Site order book:
Within 10 days of acceptance of the work
order contractor should submit a site order
book subdivision assistant engineer in
triplicates. which should be machine
Numbered.
e-tendering :
Advantages of e tendering
1. Reduced tender cycle-time.
2. Fast and accurate pre-qualification and
evaluation, which enables the automatic
rejection of suppliers that fail to meet the
tender specification.
3. Faster response to questions and points of
clarification during the tender period.
4. Reduction in the labour intensive tasks of
receipt, recording and distribution of tender
submissions.
Advantages of e tendering
4.Reduction in the labour intensive tasks of receipt,
recording and distribution of tender submissions.
5. Reduction of the paper trail on tendering
exercises, reducing costs to both councils and
Suppliers.
6.Improved audit trail increasing integrity and
transparency of the tendering process.
7. Improved quality of tender specification and
supplier response.
8. Provision of quality management information
Penalty on contractor:
slow progress: For slow progress contractor may be penalised
with 1% of the cost of the construction per week and should
not exceed 10% cost of contract.
damages: if contractor uses department equipment. repair or
replacement of equipment or plants should be done.
Termination of contract:
The executive Engineer or the competent authority is
empowered to terminate the contract in case of the
bankruptcy or default of contractor an amount up to 10%
estimated cost is forfeited if the contract is to be terminated a
notice to that effect has to be serves to the contractor.
Termination of contract:
The contract agreement may be terminated in the
following conditions:
Bankruptcy : If both or one of the parties become
bankrupt the contract may be terminated
since the work cannot be completed due to lack
of funds.
Breach of conditions : If one party fails to follow
the conditions mentioned in the contract
then the other party has every right to terminate
the contract and can also claim for damages done
to him through court of law or through arbitration
Agreement: Due to extraordinary circumstances
it may become necessary to terminate the
contract by mutual agreement. For example the
owner or contractor may expire and no other
person may be there to fulfil the agreement.
Completion of the work: If the work is
completed satisfactorily as per the conditions in
the agreement then also the contract is
terminated after making the final payment to
the contractor and releasing his security deposit.

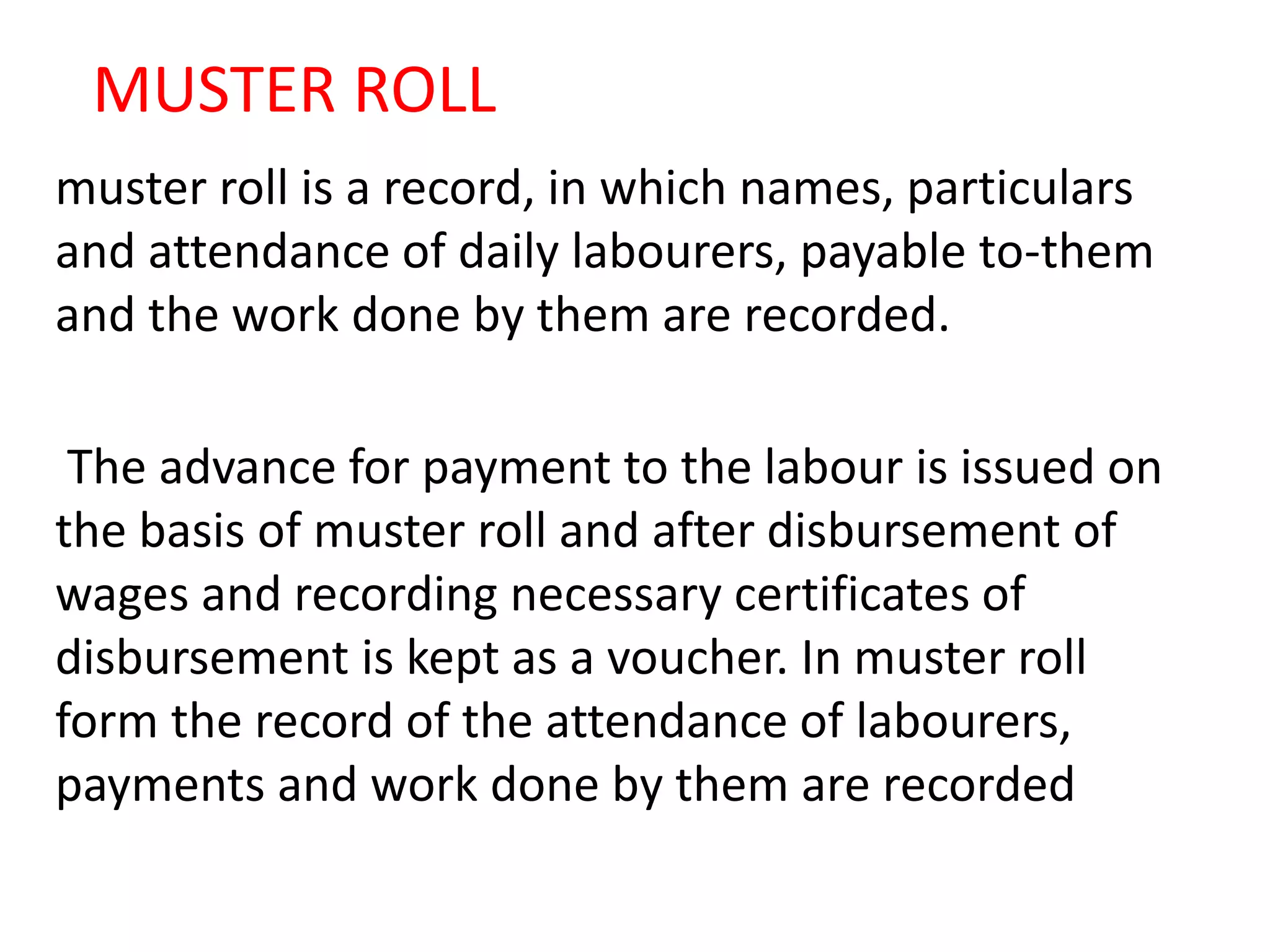

MUSTER ROLL
muster roll is a record, in which names, particulars
and attendance of daily labourers, payable to-them
and the work done by them are recorded.
The advance for payment to the labour is issued on
the basis of muster roll and after disbursement of
wages and recording necessary certificates of
disbursement is kept as a voucher. In muster roll
form the record of the attendance of labourers,
payments and work done by them are recorded
Rules for preparing muster roll:
1 . One or more muster rolls can be used for the same work.
2. Muster rolls should never be prepared in duplicate for the
same work.
3. The presence of labour should be marked with a cross mark
(X) and the absence, with letter A
4. Labourers may be paid more than once a month depending
upon local conditions, but after
each payment, separate or new muster roll has to be opened.
5. The daily record of attendance and fines should be
recorded.
6. After the muster roll has been passed, payment should be
made as early as possible by the
sub-divisional officer in the presence of subordinate
concerned, who should certify to the
payment as "paid in my presence to the right person".
common irregularities in the master rolls:
1. The labourers employed on muster roll not grouped.
2. Muster rolls contain erasures and over writings.
3. Muster rolls not signed daily. Muster rolls should be
signed daily by the person who mark the
daily attendance.
4. Attendance is not marked daily. The attendance of the
muster roll labourer should be marked
daily.
common irregularities in the master rolls:

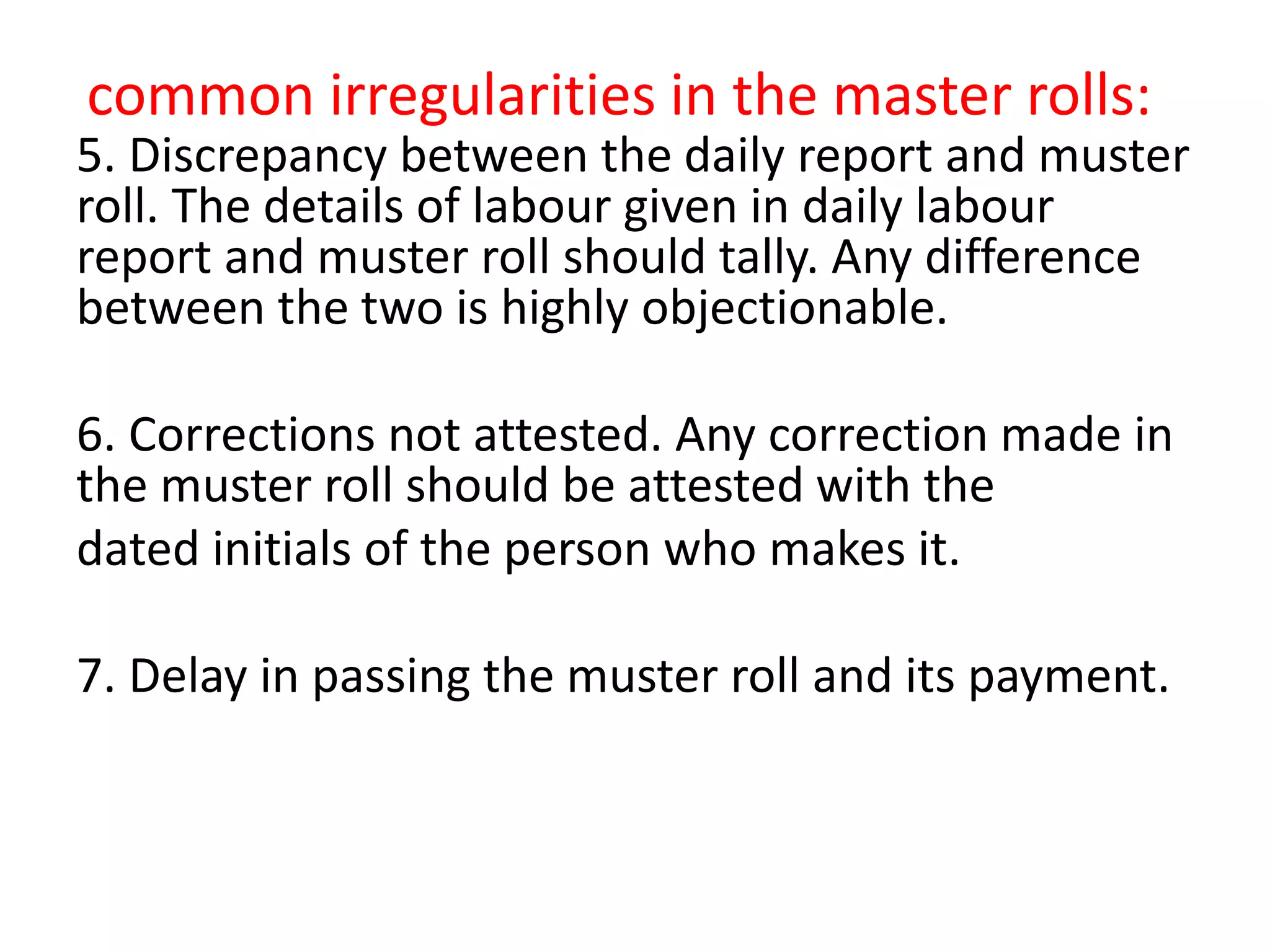

5. Discrepancy between the daily report and muster
roll. The details of labour given in daily labour
report and muster roll should tally. Any difference
between the two is highly objectionable.
6. Corrections not attested. Any correction made in
the muster roll should be attested with the
dated initials of the person who makes it.
7. Delay in passing the muster roll and its payment.
LABOUR REPORT
This report gives the following information's.
1) Category or class of labourers such as mason,
carpenter, etc.
2)Number of labourers employed in each
category.
3) Rates at which labourer employed.
4)Approximate amount of work done, etc.
MEASUREMENT BOOK(MB)
It is a book which records the measurement of all the works
and supply of materials for the purpose of payment.
all measurement books are serially numbered and pages of
each book are machine numbered. The register of
measurement book is maintained in Divisional Office showing
the serial number of each book, name of the Sub-Division to
which it is issued. The date of its issue and date of its return to
the divisional Office also will be recorded in the register. The
loss of measurement book is the serious matter which should
be reported to the higher officer and the person responsible
will be punished
Importance of MB
1)MB is initial record for all kinds of works.
2)MB are the basis for all kinds of account of
quantities.
3)MB must be accurate and kept carefully
Kinds of Measurement Books:
1) Ordinary measurement book.
2)Standard Measurement book
3)Check measurement Book
Kinds of Measurement Books:

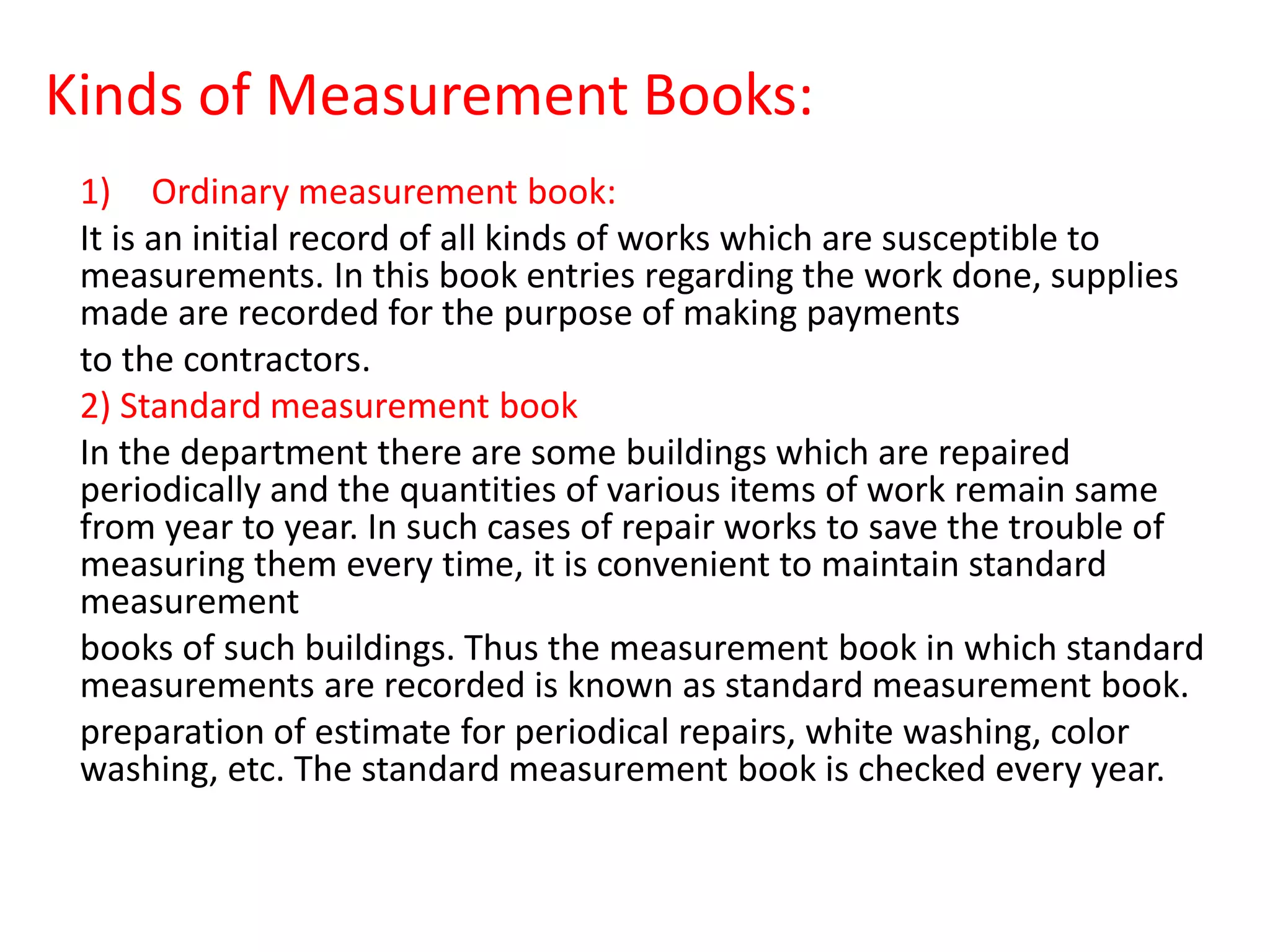

1) Ordinary measurement book:
It is an initial record of all kinds of works which are susceptible to
measurements. In this book entries regarding the work done, supplies
made are recorded for the purpose of making payments
to the contractors.
2) Standard measurement book
In the department there are some buildings which are repaired
periodically and the quantities of various items of work remain same
from year to year. In such cases of repair works to save the trouble of
measuring them every time, it is convenient to maintain standard
measurement
books of such buildings. Thus the measurement book in which standard
measurements are recorded is known as standard measurement book.
preparation of estimate for periodical repairs, white washing, color
washing, etc. The standard measurement book is checked every year.
Kinds of Measurement Books:
Advantages of standard measurement book are:
1. It facilitate the preparation of estimates for repair work from
time to time.
2. It simplifies the preparation of the contractor's bill as it is not
necessary to take detailed measurement.
3. Check measurement book
Kinds of Measurement Books:

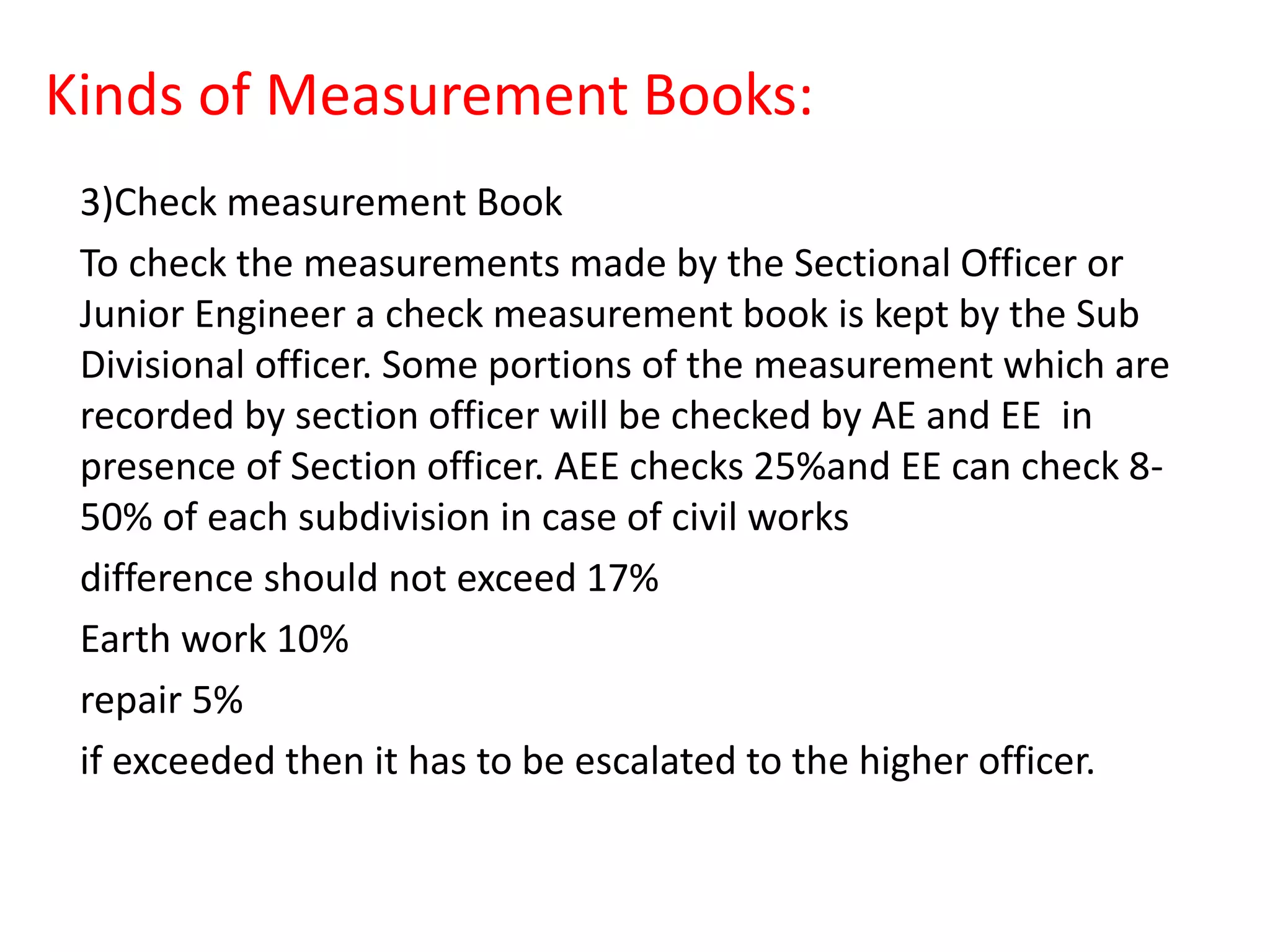

3)Check measurement Book
To check the measurements made by the Sectional Officer or
Junior Engineer a check measurement book is kept by the Sub
Divisional officer. Some portions of the measurement which are
recorded by section officer will be checked by AE and EE in
presence of Section officer. AEE checks 25%and EE can check 8-
50% of each subdivision in case of civil works
difference should not exceed 17%
Earth work 10%
repair 5%
if exceeded then it has to be escalated to the higher officer.

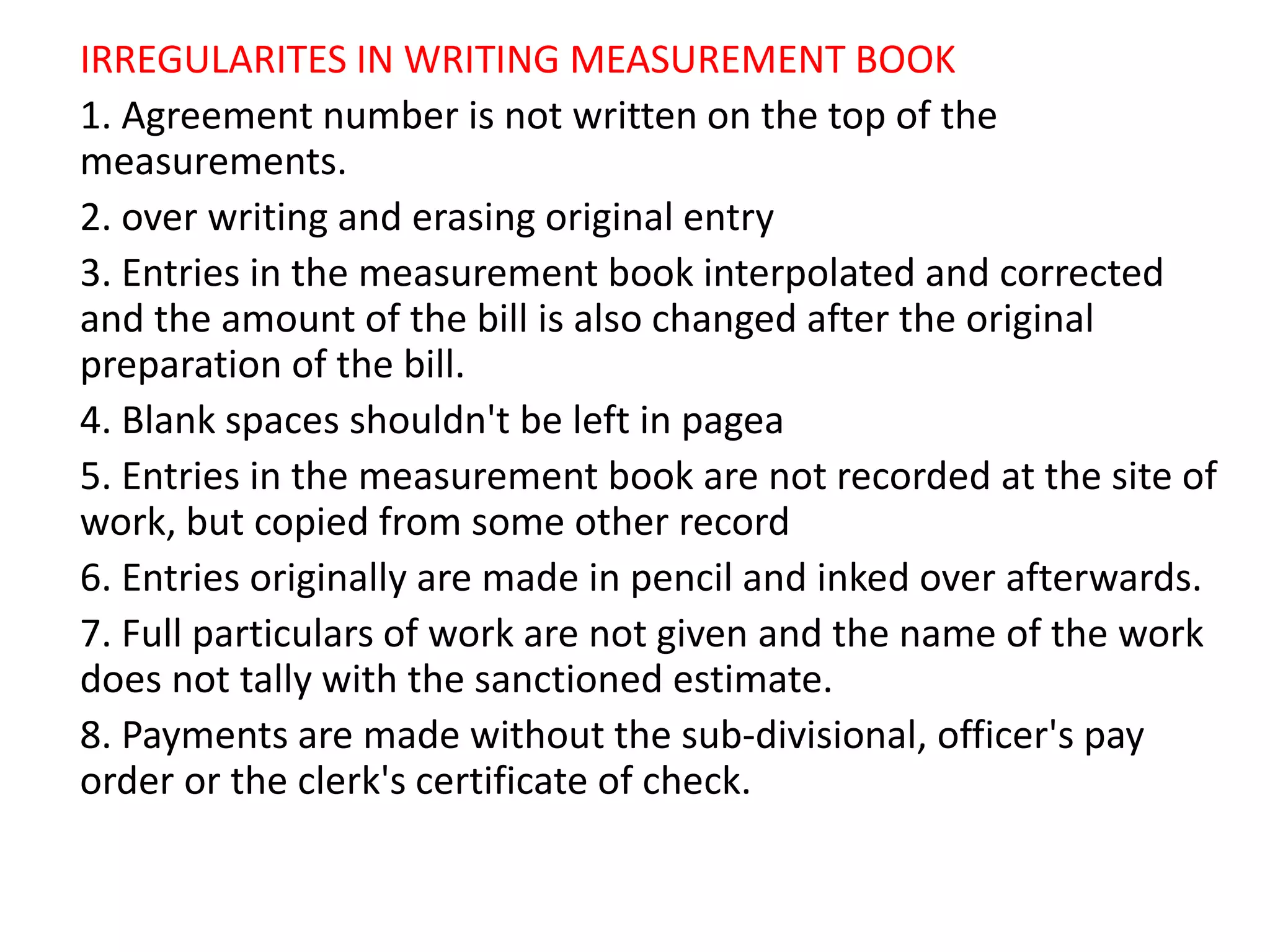

IRREGULARITES IN WRITING MEASUREMENT BOOK
1. Agreement number is not written on the top of the
measurements.
2. over writing and erasing original entry
3. Entries in the measurement book interpolated and corrected
and the amount of the bill is also changed after the original
preparation of the bill.
4. Blank spaces shouldn't be left in pagea
5. Entries in the measurement book are not recorded at the site of
work, but copied from some other record
6. Entries originally are made in pencil and inked over afterwards.
7. Full particulars of work are not given and the name of the work
does not tally with the sanctioned estimate.
8. Payments are made without the sub-divisional, officer's pay
order or the clerk's certificate of check.
IRREGULARITES IN WRITING MEASUREMENT BOOK
9. Percentage of checks by senior officers is inadequate.
10. Corrections are not attested.
11. Voucher number and date not indicated after making the
payment.
12. Index of the measurement book is not up to-date.

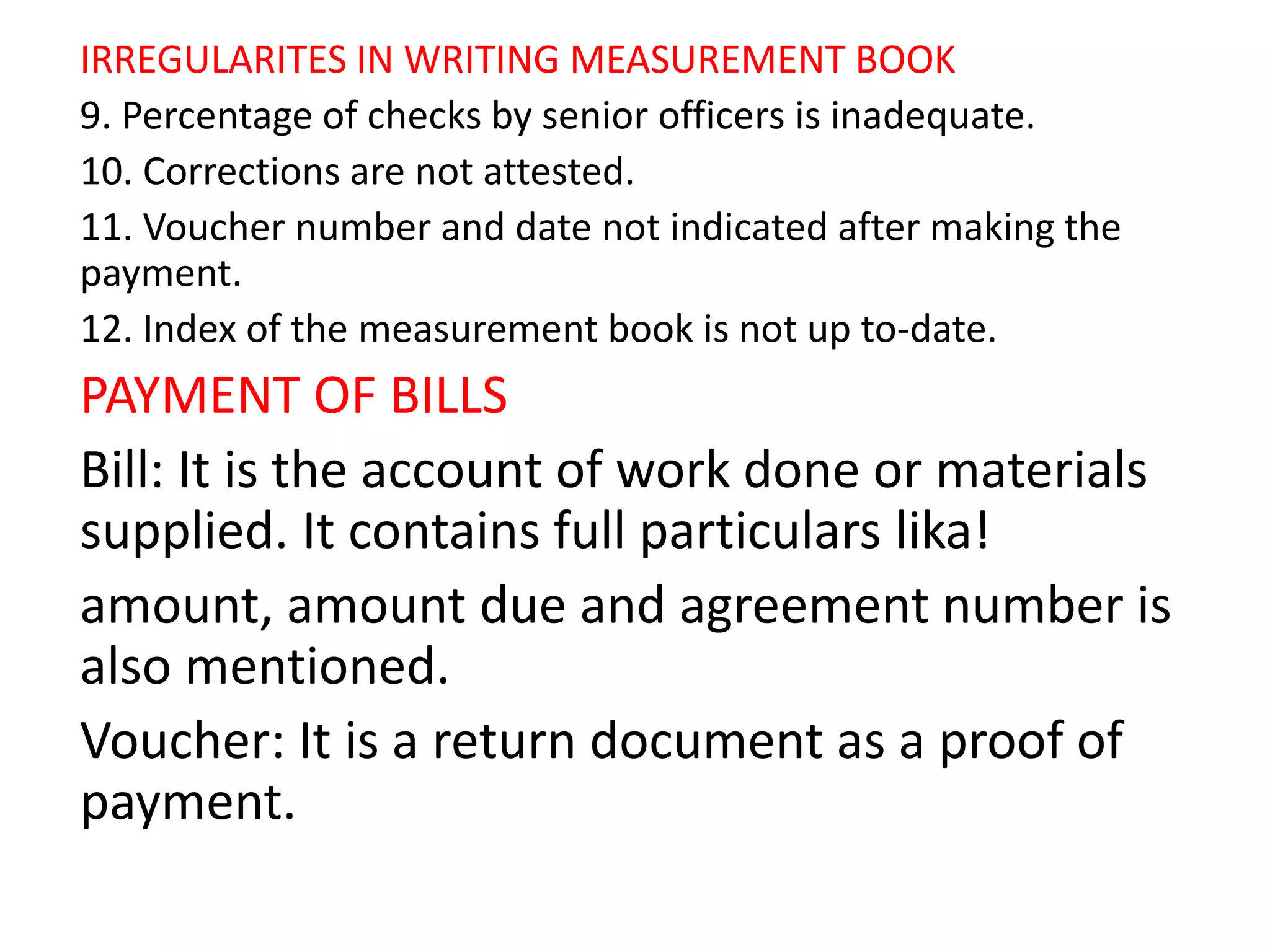

IRREGULARITES IN WRITING MEASUREMENT BOOK
9. Percentage of checks by senior officers is inadequate.
10. Corrections are not attested.
11. Voucher number and date not indicated after making the
payment.
12. Index of the measurement book is not up to-date.
PAYMENT OF BILLS
Bill: It is the account of work done or materials
supplied. It contains full particulars lika!
amount, amount due and agreement number is
also mentioned.
Voucher: It is a return document as a proof of
payment.

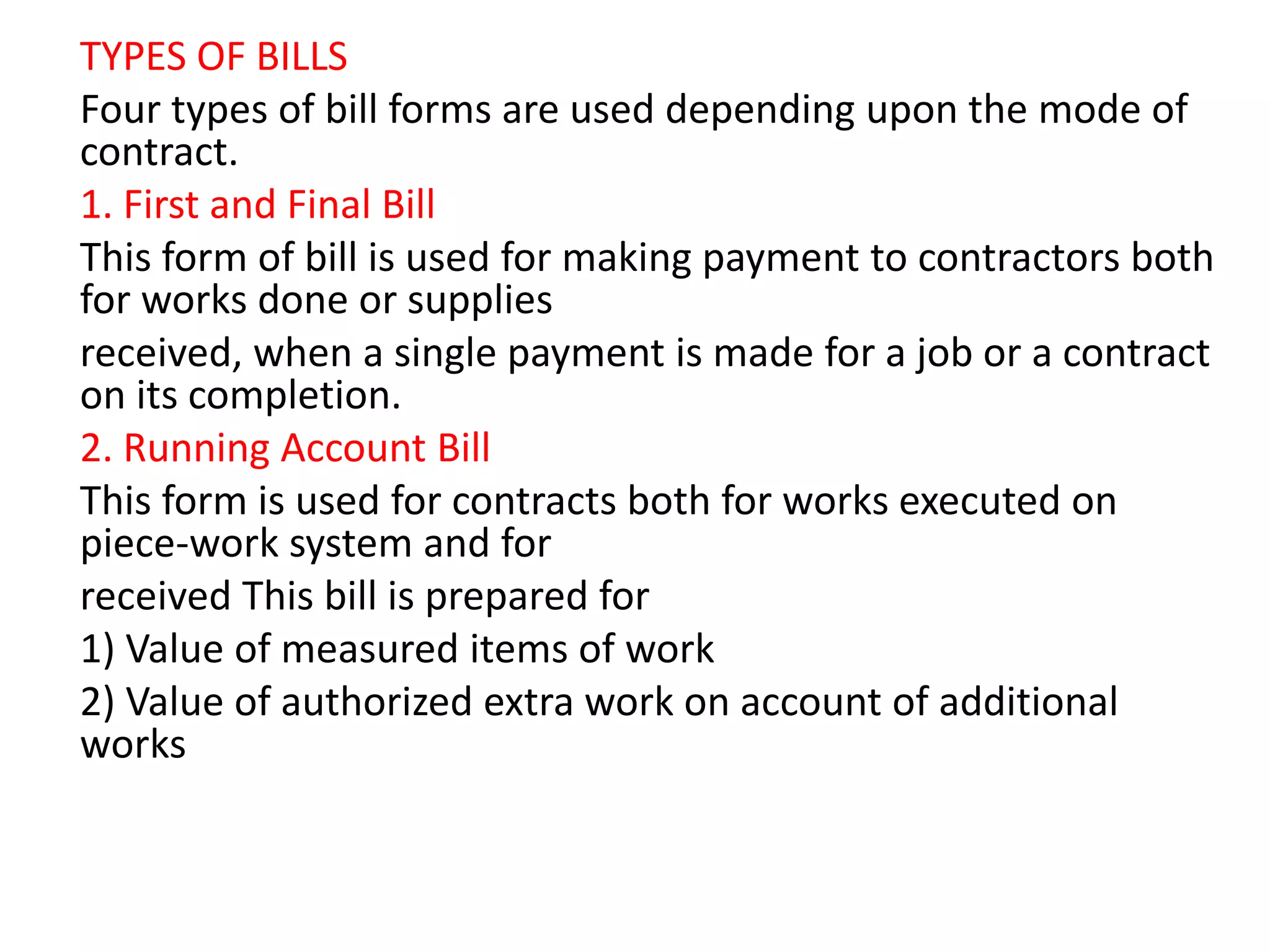

TYPES OF BILLS
Four types of bill forms are used depending upon the mode of
contract.
1. First and Final Bill
This form of bill is used for making payment to contractors both
for works done or supplies
received, when a single payment is made for a job or a contract
on its completion.
2. Running Account Bill
This form is used for contracts both for works executed on
piece-work system and for
received This bill is prepared for
1) Value of measured items of work
2) Value of authorized extra work on account of additional
works
TYPES OF BILLS
3. Lumpsum Contract Bill
In the Lumpsum contract method, a number of
intermediate payments.ie advance pay
are made in Lumpsum contract running-account bill
form before final payment.
ount bill-form before final payment is made.
4) Hand Receipt.
this is an simple voucher which is used for the small
and petty works

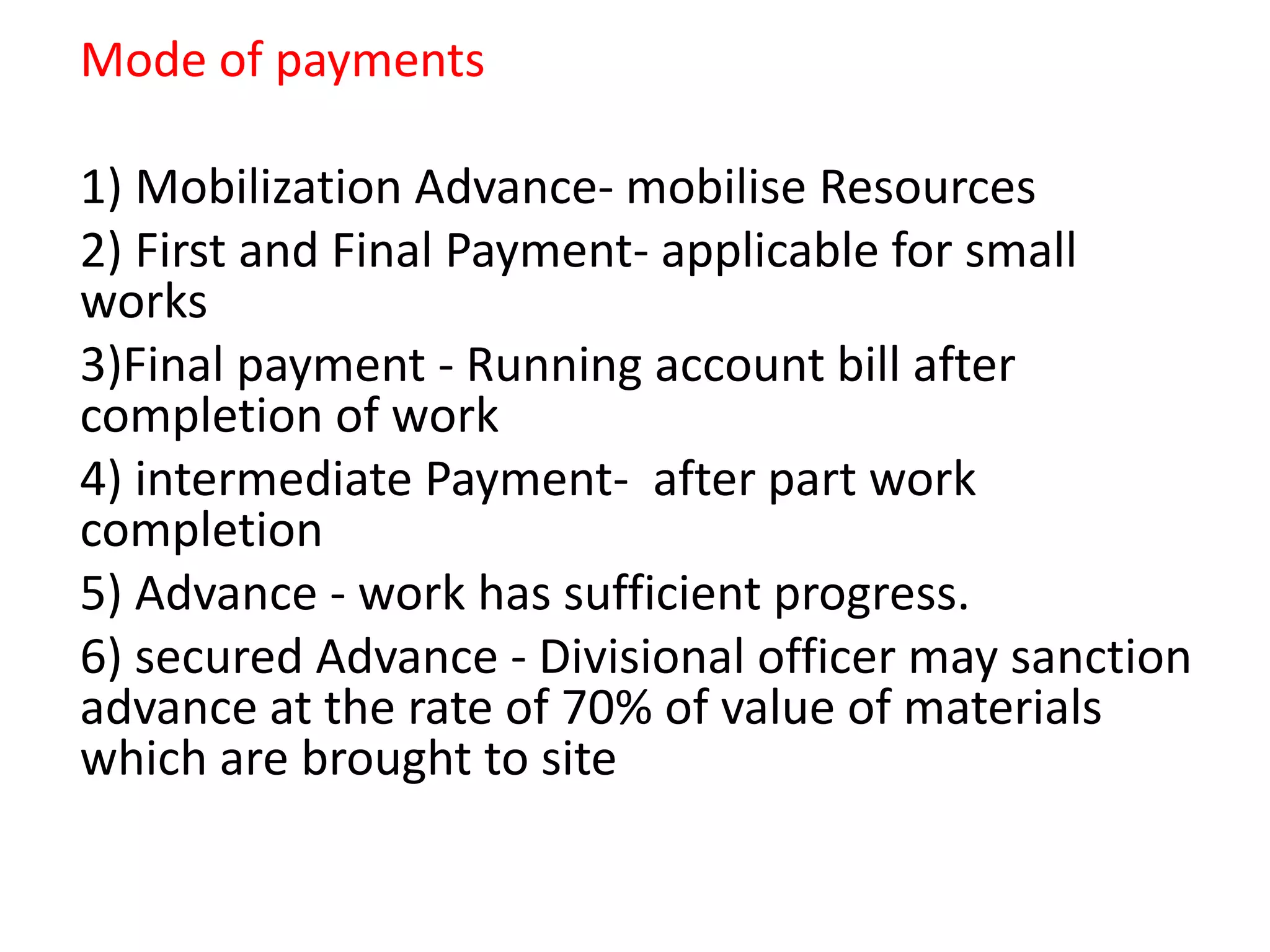

Mode of payments
1) Mobilization Advance- mobilise Resources
2) First and Final Payment- applicable for small
works
3)Final payment - Running account bill after
completion of work
4) intermediate Payment- after part work
completion
5) Advance - work has sufficient progress.
6) secured Advance - Divisional officer may sanction
advance at the rate of 70% of value of materials
which are brought to site

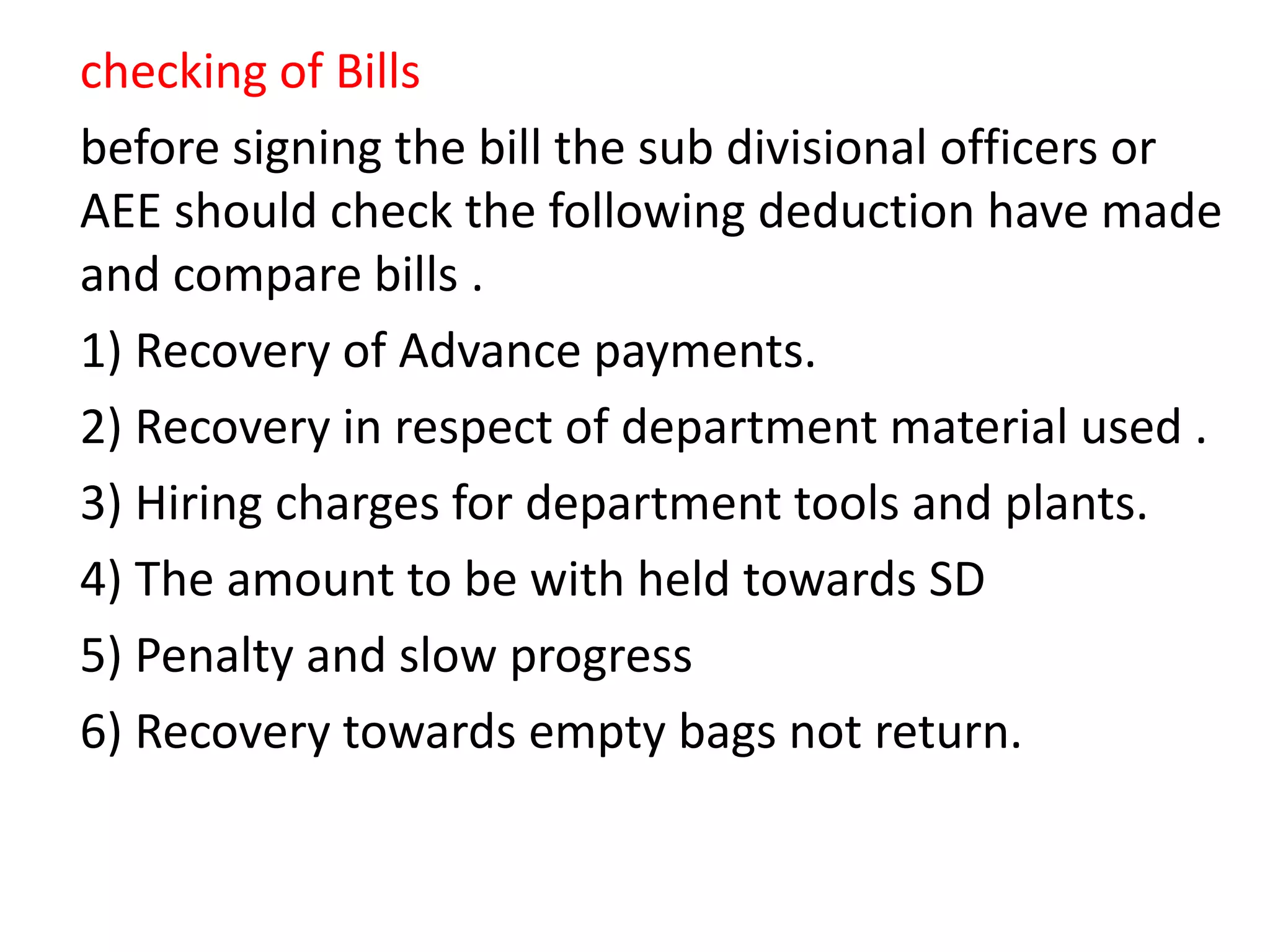

checking of Bills
before signing the bill the sub divisional officers or
AEE should check the following deduction have made
and compare bills .
1) Recovery of Advance payments.
2) Recovery in respect of department material used .
3) Hiring charges for department tools and plants.
4) The amount to be with held towards SD
5) Penalty and slow progress
6) Recovery towards empty bags not return.
checking of Bills
before signing the bill the sub divisional officers or
AEE should check the following deduction have made
and compare bills .
1) Recovery of Advance payments.
2) Recovery in respect of department material used .
3) Hiring charges for department tools and plants.
4) The amount to be with held towards SD
5) Penalty and slow progress
6) Recovery towards empty bags not return.
PASSING AND PAYMENT OF BILLS
-after checking bills arithmetic check, accuracy
and compare with contractors ledger
-memorandum of payment is made
-officer shall pass Bill on the basis of MB and
cross out it.
- the contractor is paid for the net ammount
and by cheque and acknowledgement taken for
Gross ammt

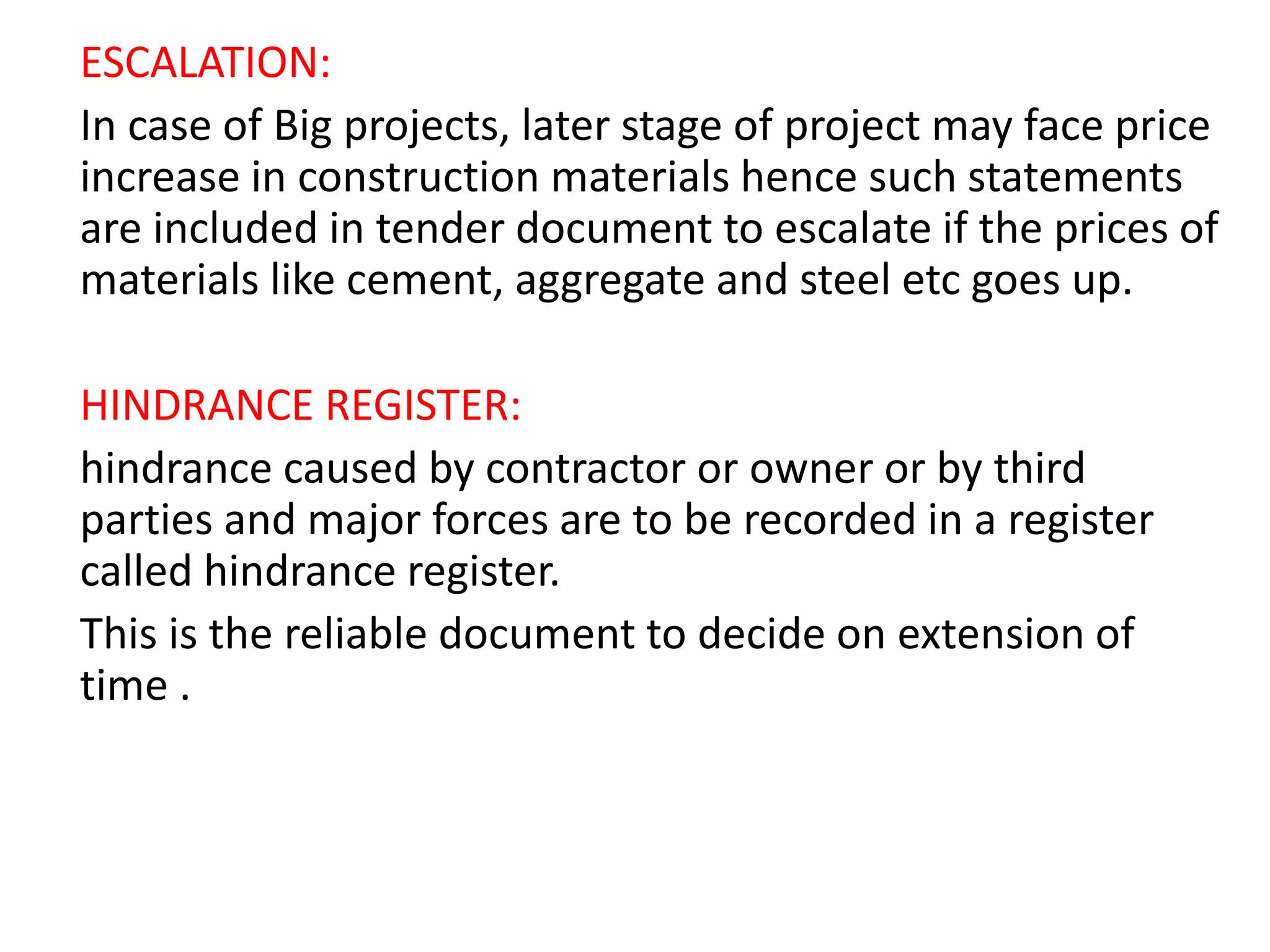

ESCALATION:
In case of Big projects, later stage of project may face price
increase in construction materials hence such statements
are included in tender document to escalate if the prices of
materials like cement, aggregate and steel etc goes up.
HINDRANCE REGISTER:
hindrance caused by contractor or owner or by third
parties and major forces are to be recorded in a register
called hindrance register.
This is the reliable document to decide on extension of
time .

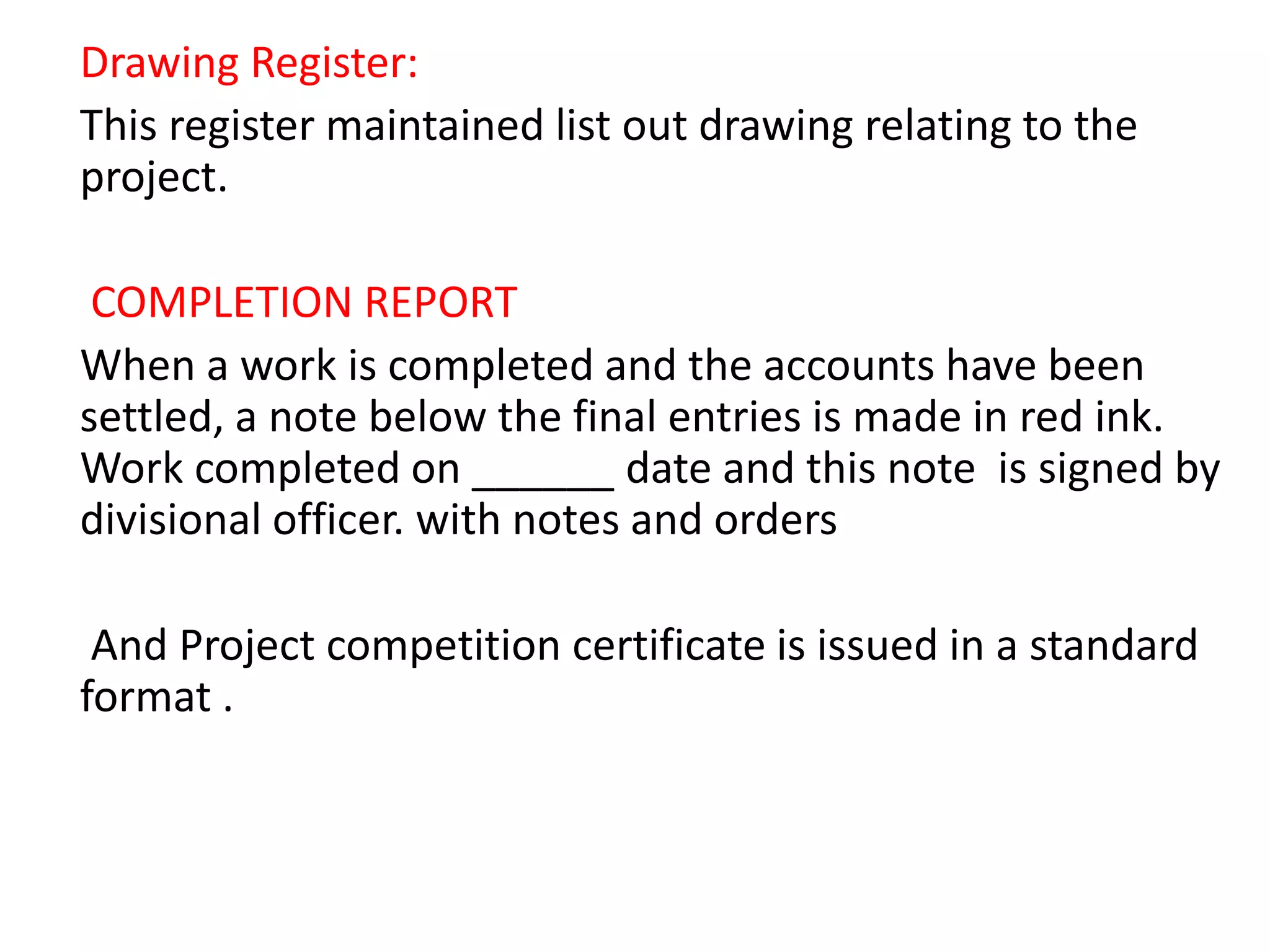

Drawing Register:
This register maintained list out drawing relating to the
project.
COMPLETION REPORT
When a work is completed and the accounts have been
settled, a note below the final entries is made in red ink.
Work completed on ______ date and this note is signed by
divisional officer. with notes and orders
And Project competition certificate is issued in a standard
format .
Principles to be followed in PWD system
 All transaction is, whether income or expenditure
have to be passed through certain specified heads
 everything should be done with certain
procedures and rules and regulations responsibility
is laid on divisional officer. and should be under
certain heads of account.
1) Expenditure heads.
2) Revenue Heads
3) Remittance head
4) Debit or depository heads

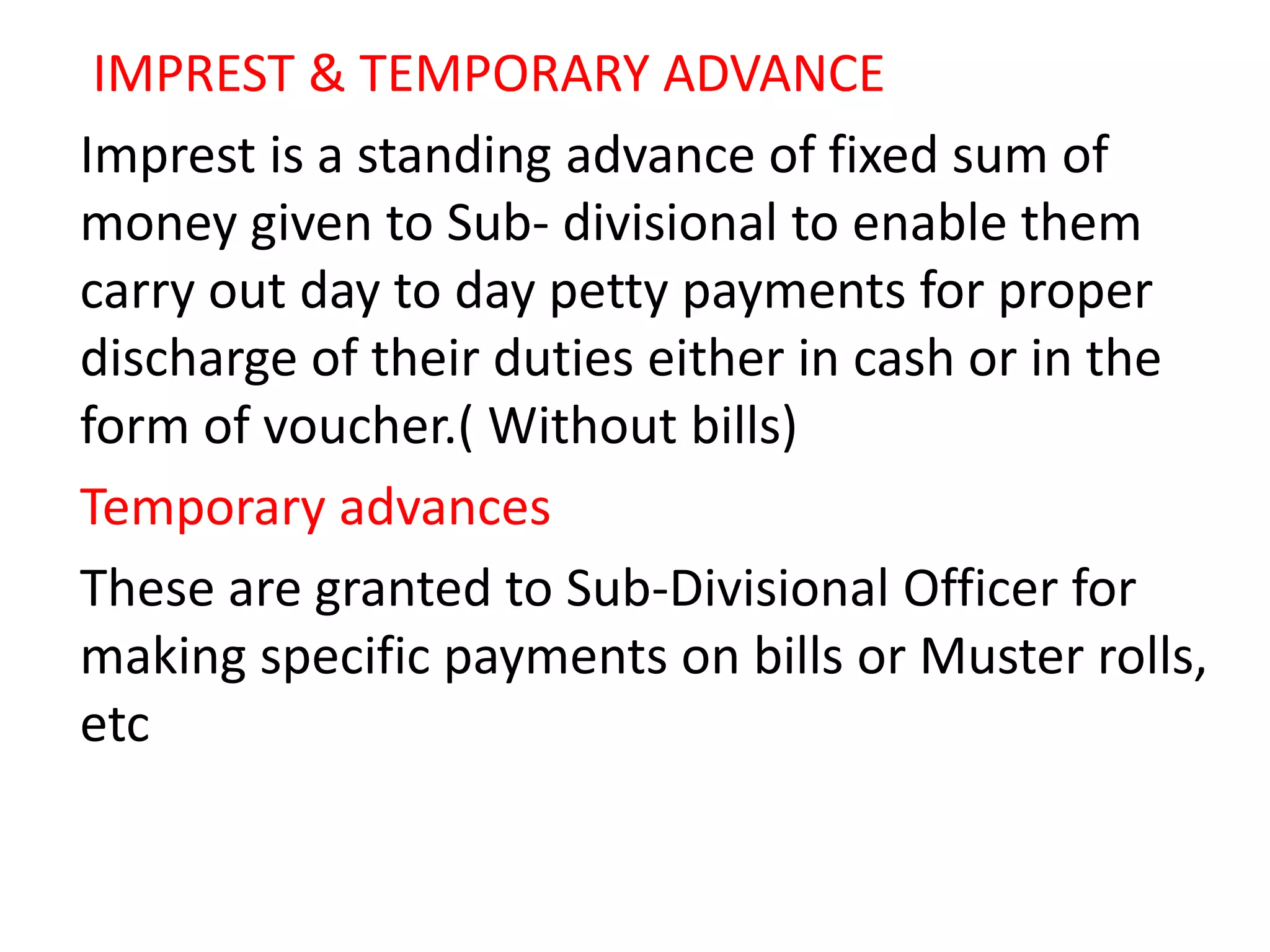

IMPREST & TEMPORARY ADVANCE
Imprest is a standing advance of fixed sum of
money given to Sub- divisional to enable them
carry out day to day petty payments for proper
discharge of their duties either in cash or in the
form of voucher.( Without bills)
Temporary advances
These are granted to Sub-Divisional Officer for
making specific payments on bills or Muster rolls,
etc

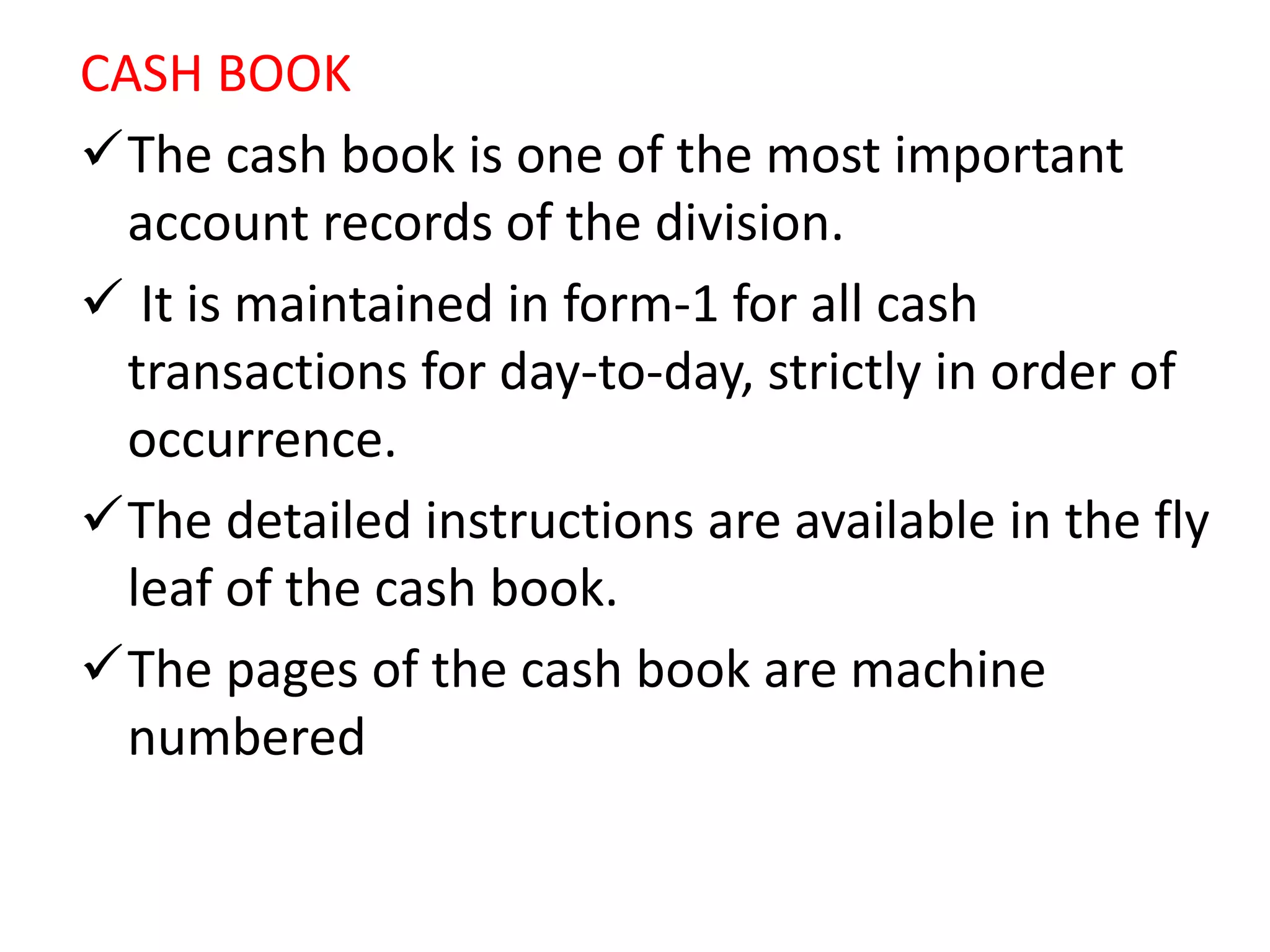

CASH BOOK
The cash book is one of the most important
account records of the division.
 It is maintained in form-1 for all cash
transactions for day-to-day, strictly in order of
occurrence.
The detailed instructions are available in the fly
leaf of the cash book.
The pages of the cash book are machine
numbered

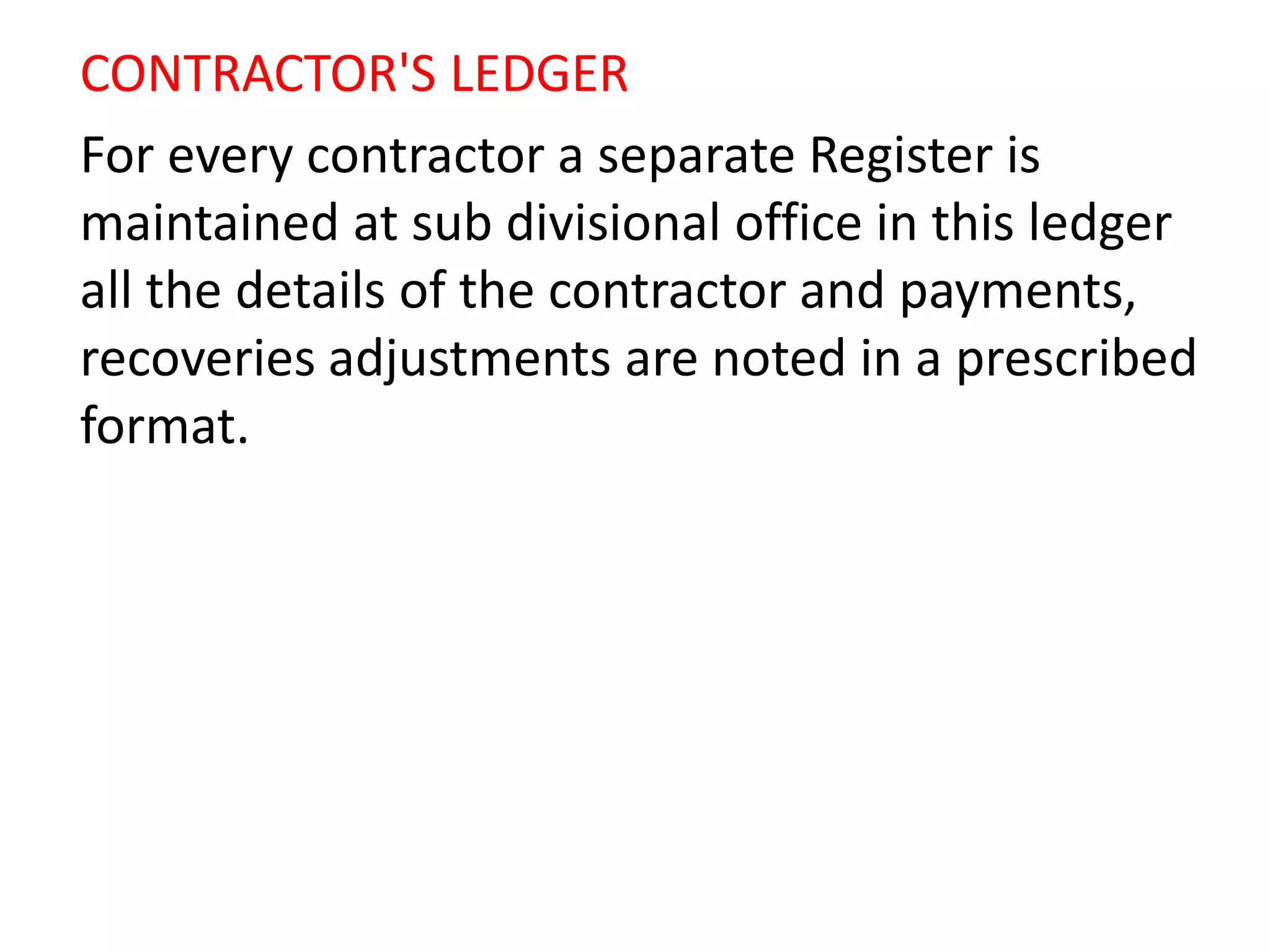

CONTRACTOR'S LEDGER
For every contractor a separate Register is
maintained at sub divisional office in this ledger
all the details of the contractor and payments,
recoveries adjustments are noted in a prescribed
format.

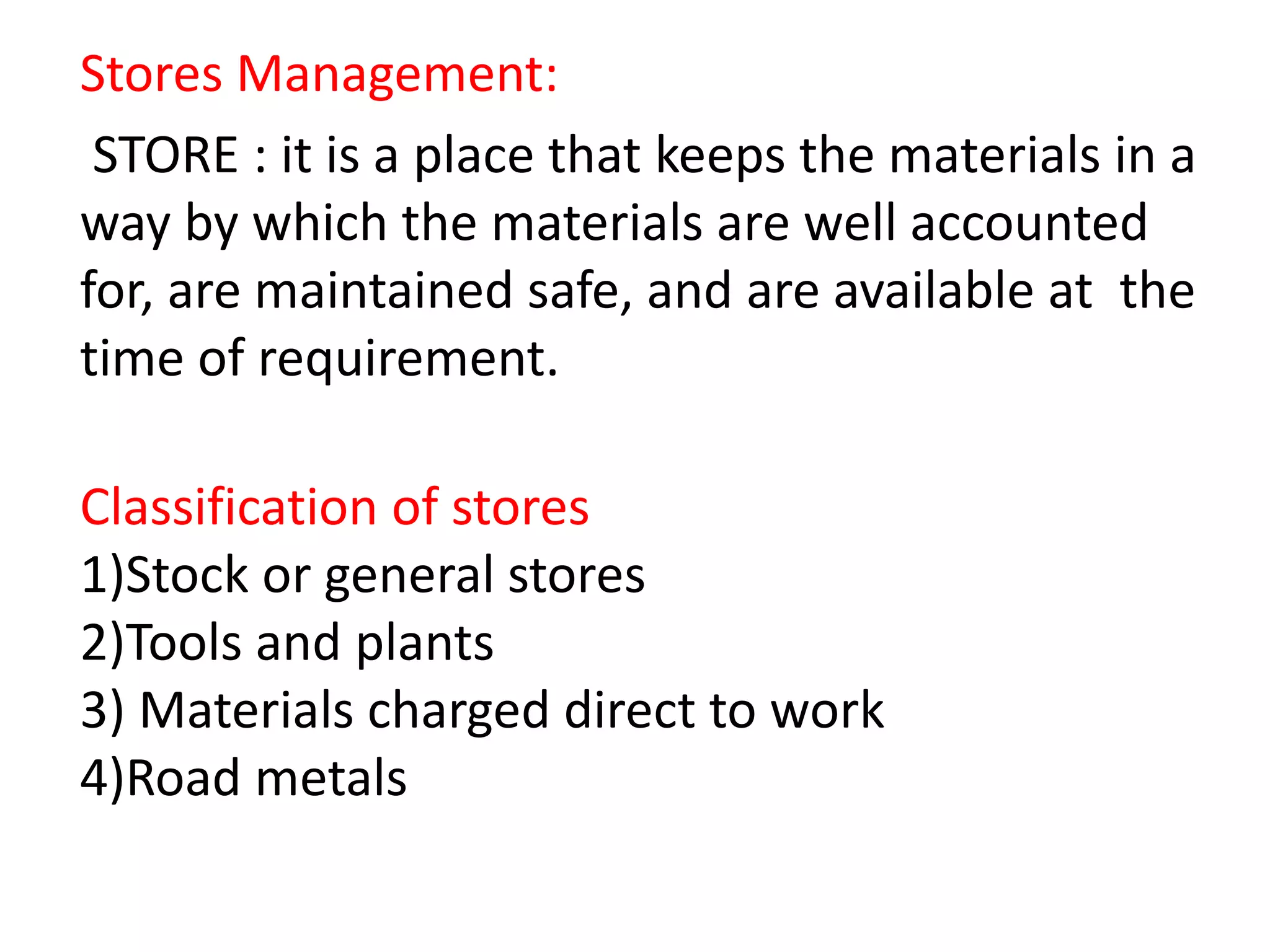

Stores Management:
STORE : it is a place that keeps the materials in a
way by which the materials are well accounted
for, are maintained safe, and are available at the
time of requirement.
Stores Management:
STORE : it is a place that keeps the materials in a
way by which the materials are well accounted
for, are maintained safe, and are available at the
time of requirement.
Classification of stores
1)Stock or general stores
2)Tools and plants
3) Materials charged direct to work
4)Road metals
1)stock or General Stores
Department keeps all the necessary construction
materials to avoid delay
Sub heads are
1) small stores : nails , screws nuts bolts etc
2) Building materials : cement brick steel etc
3) timber: teak wood etc
4) Metals : iron rolled, sections etc
5) fuel and lubricants coal petrol
6) Painter store: paints brush etc
7) House fittings
8) Miscellaneous store : pipes empty drums etc
9) Manufacture
2) Tools and plants
1) General or ordinary tools and plants
2) Special tools and plants
Sub heads of Tools and plants:
1) Plants and machinery- fixed, movable,
locomotive, vehicles,road making
2) Tools -Fixed(lathe), saw drills etc
3) Scientific apparatus and instruments-pippet ,
thermometer, breakers, surveying instruments-
chain tape theodolite,total station etc

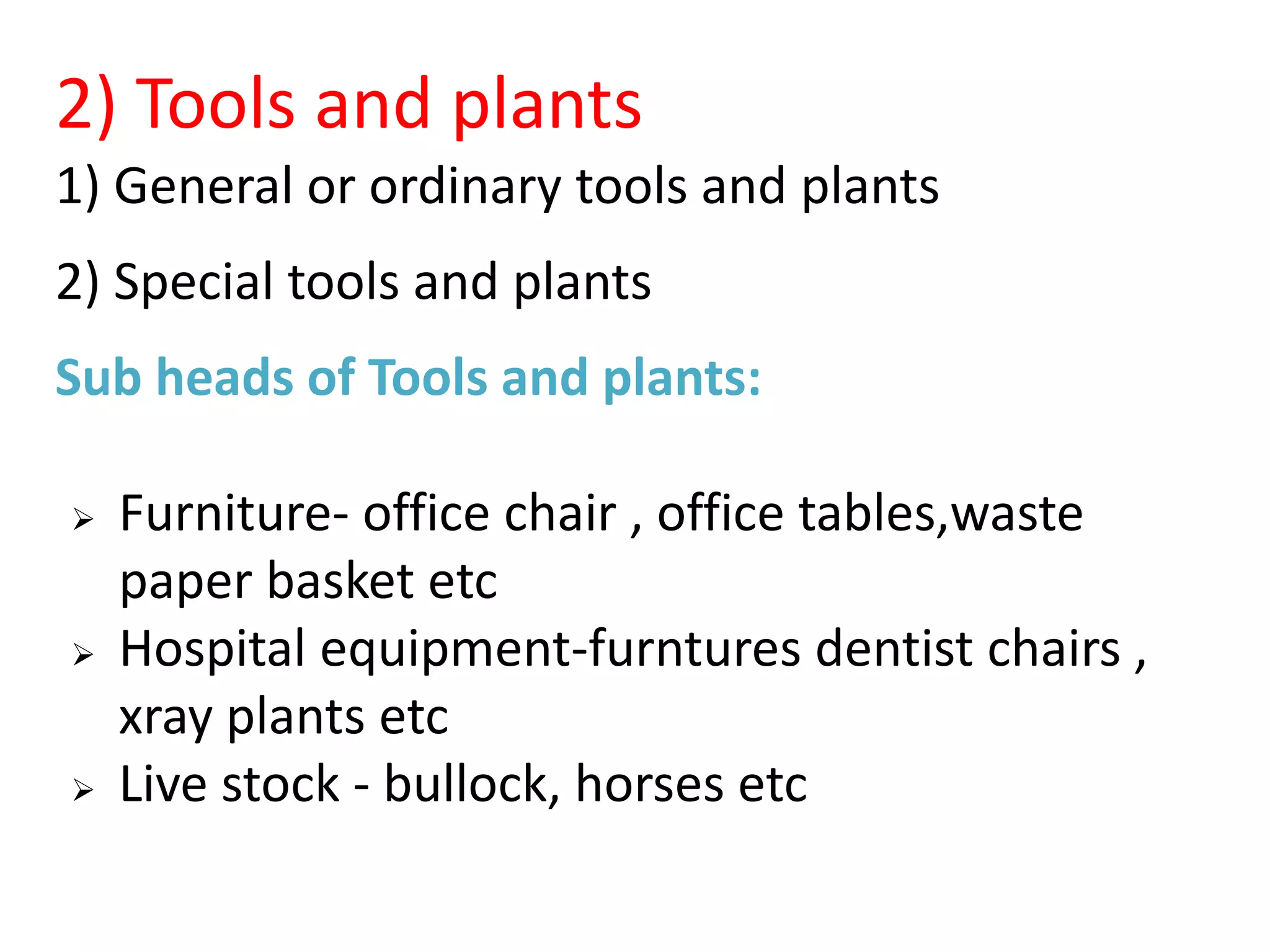

2) Tools and plants
1) General or ordinary tools and plants
2) Special tools and plants
Sub heads of Tools and plants:
 Furniture- office chair , office tables,waste
paper basket etc
 Hospital equipment-furntures dentist chairs ,
xray plants etc
 Live stock - bullock, horses etc
Maintenance of stores
Points to be considered for storages of materials
1) Combustible materials should be kept
separately to avoid fire accidents.
2) oil should be stored in seperate store over the
sand
3) petroleum should be stored in under ground
tanks.
Maintenance of stores
4) Textile material should be protected from
attack of insects
5)coal charcoal should be stored in bins
6)all iron and steel should be grouped as per size
7)Road metals are stores on level ground.
8)canvas material should be exposed to sunlight
and dried often .
9)all wood items should be periodically examined
and preventive measures should be taken.
ISSUES:
The materials are issued from stocks for following
1)Either for direct use or for contractors use
2)For sale to contractor or to the other person
3) transfer to other stores within division
4)For dispatch to other departments

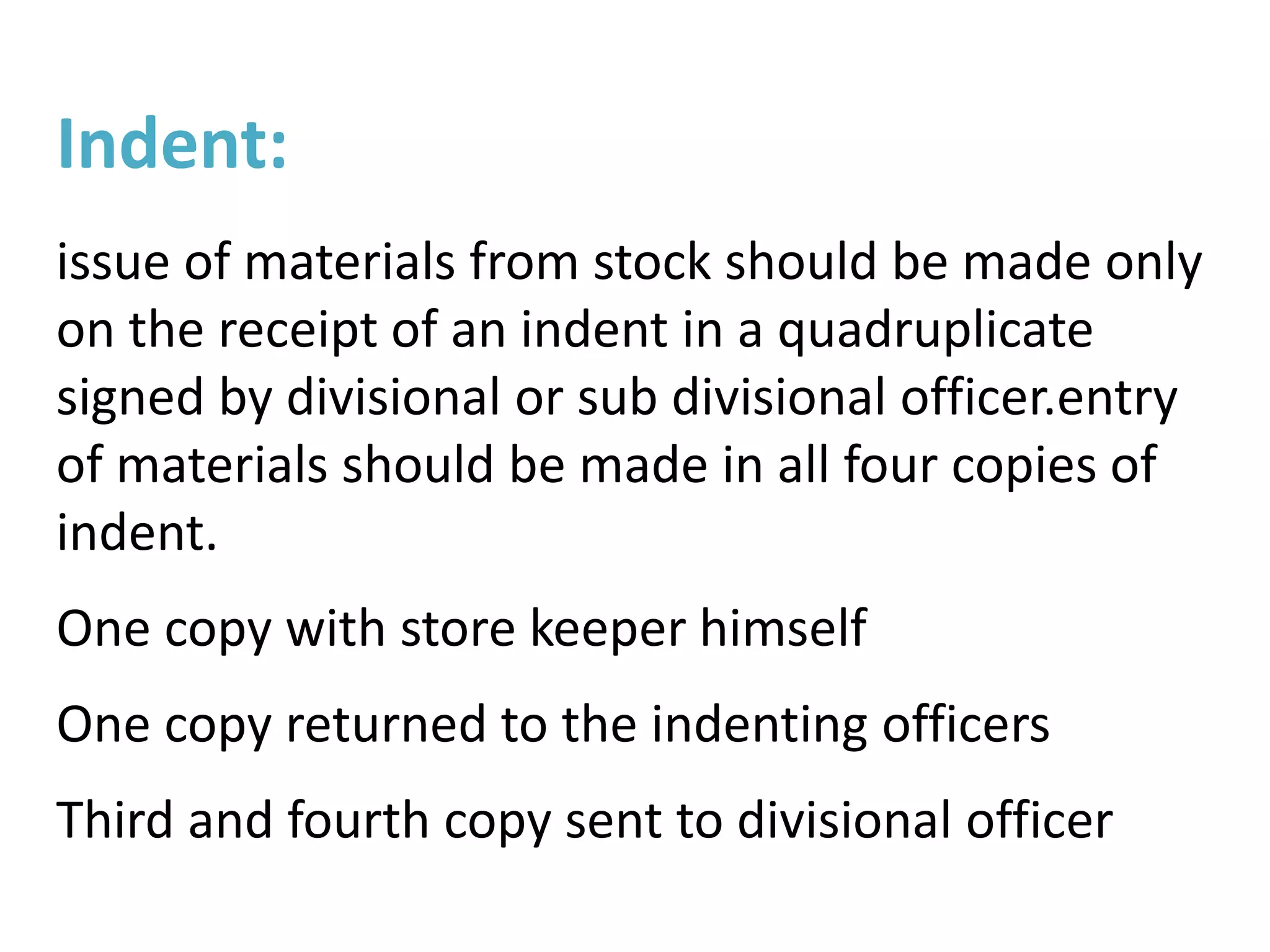

Indent:
issue of materials from stock should be made only
on the receipt of an indent in a quadruplicate
signed by divisional or sub divisional officer.entry
of materials should be made in all four copies of
indent.
One copy with store keeper himself
One copy returned to the indenting officers
Third and fourth copy sent to divisional officer
Invoice:
The invoice is available in tge standard format
which should be filled up when the materials are
to be supplied.It should be sent along with the
materials to the indenting officers for his
acknowledgements. Indenting officers should sign
and return it to the store keeper. Invoice should
be in triplicates
One original will be in invoice book
2 will be sent to divisional officer.

Bin card:
In stores, a number of materials are to be
handled. Details of information about the
stock position,drawel rate per month, when
the order of perticular material is placed are
all entered on bin card .
Specimen of Bin card:

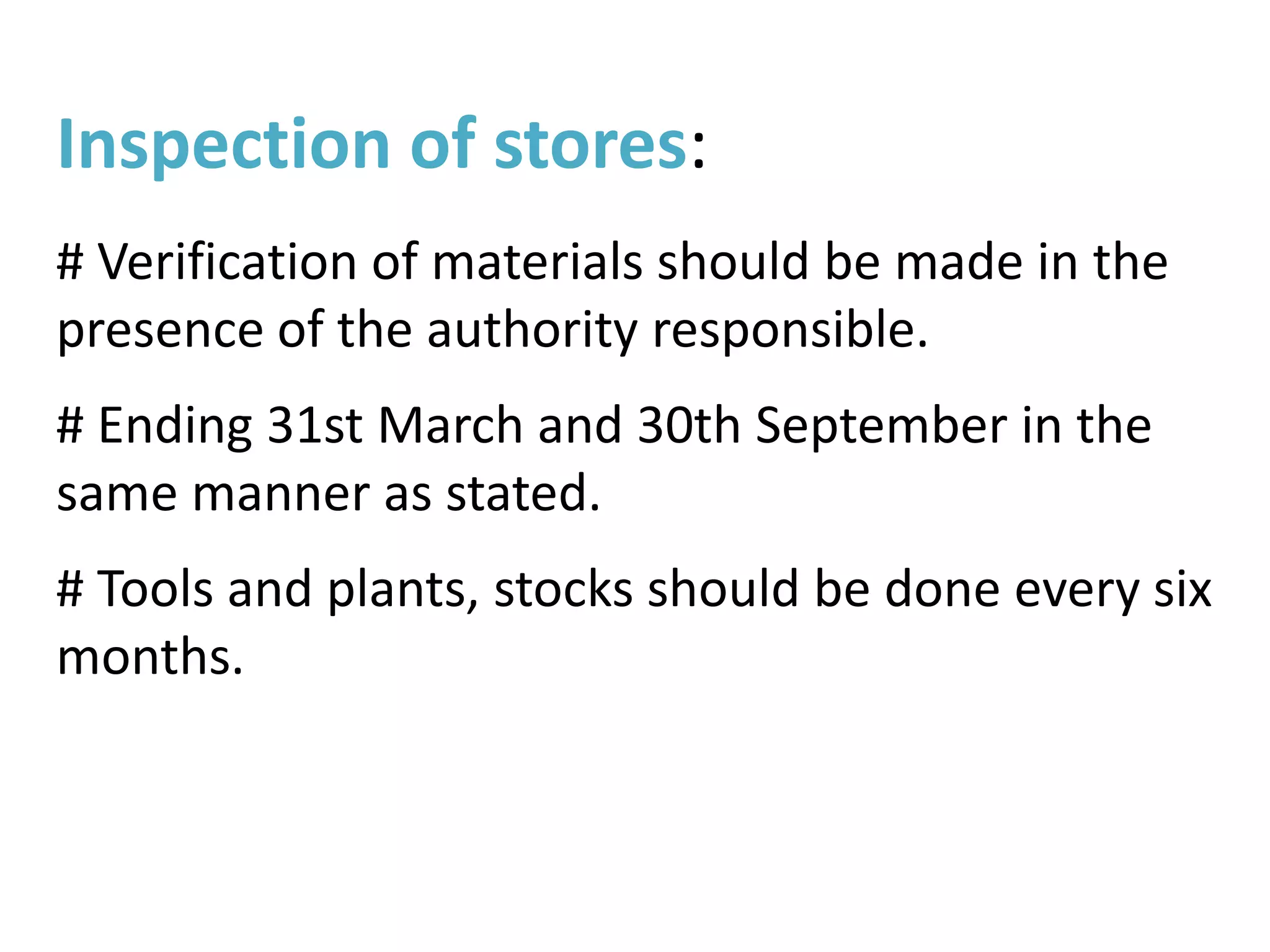

Inspection of stores:
# Verification of materials should be made in the
presence of the authority responsible.
# Ending 31st March and 30th September in the
same manner as stated.
# Tools and plants, stocks should be done every six
months.

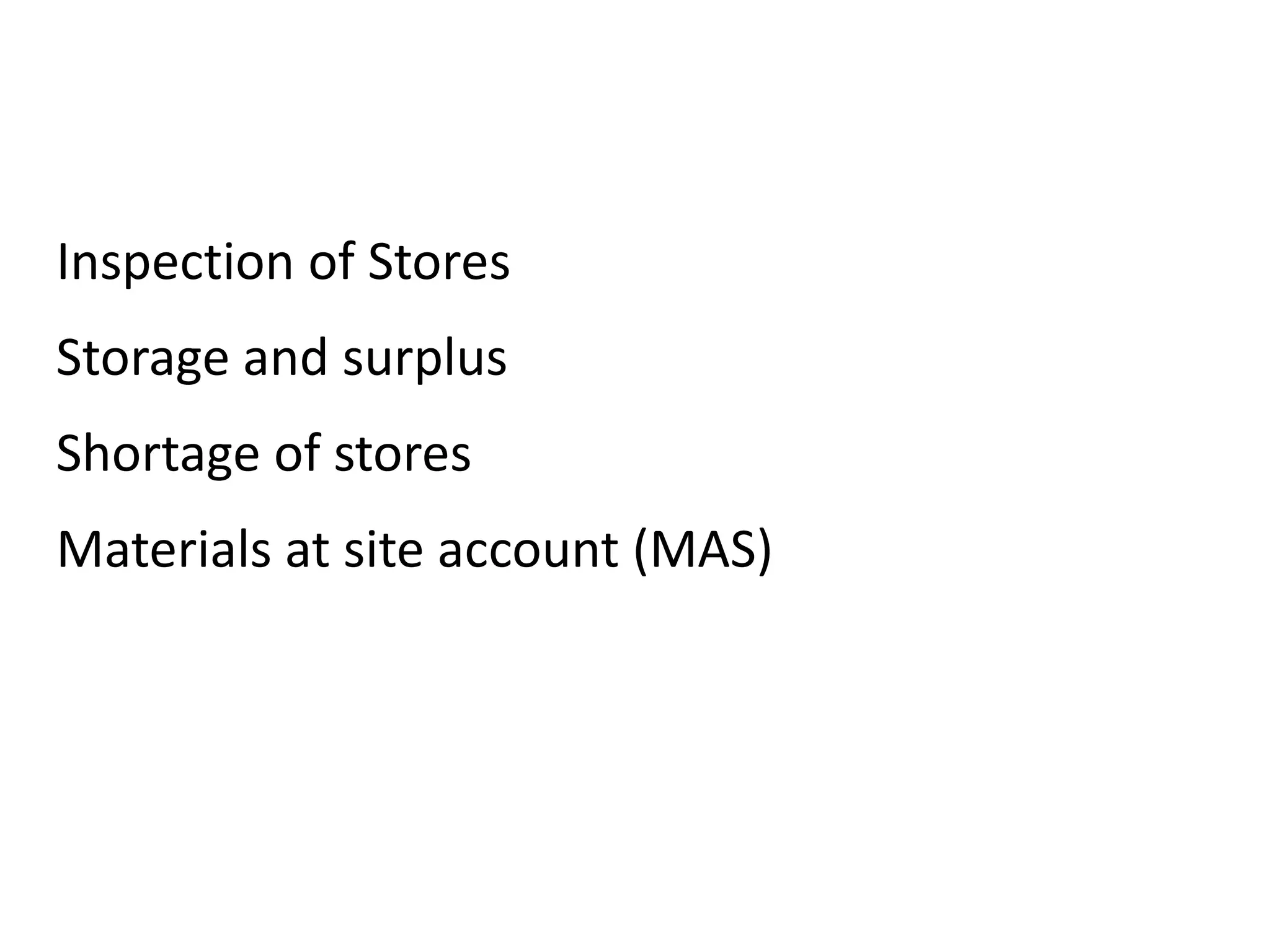

Inspection of Stores
Storage and surplus
Shortage of stores
Materials at site account (MAS)
Construction practices

More Related Content

What's hot

civil engineering-Contracts
civil engineering-Contractscivil engineering-Contracts
civil engineering-ContractsNikhil Kumar

Construction contract
Construction contract Construction contract
Construction contract Rakshith Reddy

Tenders contract -arti
Tenders contract -artiTenders contract -arti
Tenders contract -artijagadish108

Construction contracts docuements_08092008
Construction contracts docuements_08092008Construction contracts docuements_08092008
Construction contracts docuements_08092008AYM1979

Tender & Tender Notice
Tender & Tender NoticeTender & Tender Notice
Tender & Tender NoticeSakshi Kirar

Contract payment and variation
Contract payment and variationContract payment and variation
Contract payment and variationVj NiroSh

Estimating, administrative approval, technical sanction, budget provision
Estimating, administrative approval, technical sanction, budget provisionEstimating, administrative approval, technical sanction, budget provision
Estimating, administrative approval, technical sanction, budget provisionAshwiniChaudhari13

Contract and Arbitration
Contract and ArbitrationContract and Arbitration
Contract and ArbitrationJIT KUMAR GUPTA

Maintenance and repair of buildings.
Maintenance and repair of buildings.Maintenance and repair of buildings.
Maintenance and repair of buildings.Satyaki Sikdar

estimation,its types and methods
estimation,its types and methodsestimation,its types and methods
estimation,its types and methodsgayu pandian

Fidic conditions of contract presentation
Fidic conditions of contract presentationFidic conditions of contract presentation
Fidic conditions of contract presentationJeff B

Specifications, reports and tenders
Specifications, reports and tendersSpecifications, reports and tenders
Specifications, reports and tendersgayu pandian

Pre qualification stages and tender selection
Pre qualification stages and tender selectionPre qualification stages and tender selection
Pre qualification stages and tender selectionanojan kanagarathnam

What's hot (20)

Unit-2_Tender
Unit-2_TenderUnit-2_Tender
Unit-2_Tender

civil engineering-Contracts
civil engineering-Contractscivil engineering-Contracts
civil engineering-Contracts

Construction contract
Construction contract Construction contract
Construction contract

Tenders contract -arti
Tenders contract -artiTenders contract -arti
Tenders contract -arti

Earnest Money
Earnest MoneyEarnest Money
Earnest Money

Item rate contract
Item rate contractItem rate contract
Item rate contract

Construction contracts docuements_08092008
Construction contracts docuements_08092008Construction contracts docuements_08092008
Construction contracts docuements_08092008

Tender
TenderTender
Tender

Tender & Tender Notice
Tender & Tender NoticeTender & Tender Notice
Tender & Tender Notice

Contract payment and variation
Contract payment and variationContract payment and variation
Contract payment and variation

Estimating, administrative approval, technical sanction, budget provision
Estimating, administrative approval, technical sanction, budget provisionEstimating, administrative approval, technical sanction, budget provision
Estimating, administrative approval, technical sanction, budget provision

Contract and Arbitration
Contract and ArbitrationContract and Arbitration
Contract and Arbitration

TENDER DOCUMENT
TENDER DOCUMENTTENDER DOCUMENT
TENDER DOCUMENT

contract procedure
contract procedurecontract procedure
contract procedure

Maintenance and repair of buildings.
Maintenance and repair of buildings.Maintenance and repair of buildings.
Maintenance and repair of buildings.

estimation,its types and methods
estimation,its types and methodsestimation,its types and methods
estimation,its types and methods

Fidic conditions of contract presentation
Fidic conditions of contract presentationFidic conditions of contract presentation
Fidic conditions of contract presentation

Specifications, reports and tenders
Specifications, reports and tendersSpecifications, reports and tenders
Specifications, reports and tenders

Pre qualification stages and tender selection
Pre qualification stages and tender selectionPre qualification stages and tender selection
Pre qualification stages and tender selection

tendering
 tendering tendering
tendering

Similar to Construction practices

Cost estimates & contract documents ce224 pdf
Cost estimates & contract documents   ce224 pdfCost estimates & contract documents   ce224 pdf
Cost estimates & contract documents ce224 pdfSaqib Imran

CE-CONTRACTS-REPORT.pdf
CE-CONTRACTS-REPORT.pdfCE-CONTRACTS-REPORT.pdf
CE-CONTRACTS-REPORT.pdfChelDems

Chapter-2 Construction Contract. Subject code:3160614ptx
Chapter-2 Construction Contract. Subject code:3160614ptxChapter-2 Construction Contract. Subject code:3160614ptx
Chapter-2 Construction Contract. Subject code:3160614ptxsulevrunda

5 Popular Types of Construction Contracts
5 Popular Types of Construction Contracts5 Popular Types of Construction Contracts
5 Popular Types of Construction ContractsSHAZEBALIKHAN1

contracts-unit 3.ppt
contracts-unit 3.pptcontracts-unit 3.ppt
contracts-unit 3.pptmayuray

Types of tender and their processing.
Types of tender and their processing.Types of tender and their processing.
Types of tender and their processing.Abhishek kumar maurya

Types of Tender and their Process
Types of Tender and their ProcessTypes of Tender and their Process
Types of Tender and their Processarpantripathi2

Final types of contracts- different types of contracts
Final types of contracts- different types of contractsFinal types of contracts- different types of contracts
Final types of contracts- different types of contractsMohammedAlfayad2

Contracts - Estimation, Costing and Valuation Engineering
Contracts - Estimation, Costing and Valuation EngineeringContracts - Estimation, Costing and Valuation Engineering
Contracts - Estimation, Costing and Valuation EngineeringShanmugasundaram N

ZA CONTRACT AL NOOR.docx
ZA CONTRACT AL NOOR.docxZA CONTRACT AL NOOR.docx
ZA CONTRACT AL NOOR.docxFairFASST

types of contracts
 types of contracts types of contracts
types of contractsKEVINMISTRY8

Contracts and their types
Contracts and their typesContracts and their types
Contracts and their typesTouqeer1

Job,batch and contract costing
Job,batch and contract costingJob,batch and contract costing
Job,batch and contract costingCollen Mahambo

3 Type of contracts.pdf
3 Type of contracts.pdf3 Type of contracts.pdf
3 Type of contracts.pdfThanoonQasem

Similar to Construction practices (20)

Cost estimates & contract documents ce224 pdf
Cost estimates & contract documents   ce224 pdfCost estimates & contract documents   ce224 pdf
Cost estimates & contract documents ce224 pdf

CE-CONTRACTS-REPORT.pdf
CE-CONTRACTS-REPORT.pdfCE-CONTRACTS-REPORT.pdf
CE-CONTRACTS-REPORT.pdf

Chapter-2 Construction Contract. Subject code:3160614ptx
Chapter-2 Construction Contract. Subject code:3160614ptxChapter-2 Construction Contract. Subject code:3160614ptx
Chapter-2 Construction Contract. Subject code:3160614ptx

Construction contract
Construction contractConstruction contract
Construction contract

Construction contract
Construction contractConstruction contract
Construction contract

Unit-1_Contracts
Unit-1_ContractsUnit-1_Contracts
Unit-1_Contracts

5 Popular Types of Construction Contracts
5 Popular Types of Construction Contracts5 Popular Types of Construction Contracts
5 Popular Types of Construction Contracts

contracts-unit 3.ppt
contracts-unit 3.pptcontracts-unit 3.ppt
contracts-unit 3.ppt

Types of tender and their processing.
Types of tender and their processing.Types of tender and their processing.
Types of tender and their processing.

Types of Tender and their Process
Types of Tender and their ProcessTypes of Tender and their Process
Types of Tender and their Process

Final types of contracts- different types of contracts
Final types of contracts- different types of contractsFinal types of contracts- different types of contracts
Final types of contracts- different types of contracts

Contracts & tenders
Contracts & tendersContracts & tenders
Contracts & tenders

Contracts - Estimation, Costing and Valuation Engineering
Contracts - Estimation, Costing and Valuation EngineeringContracts - Estimation, Costing and Valuation Engineering
Contracts - Estimation, Costing and Valuation Engineering

ZA CONTRACT AL NOOR.docx
ZA CONTRACT AL NOOR.docxZA CONTRACT AL NOOR.docx
ZA CONTRACT AL NOOR.docx

types of contracts
 types of contracts types of contracts
types of contracts

Contracts and their types
Contracts and their typesContracts and their types
Contracts and their types

Contracts
ContractsContracts
Contracts

Chapter 4- Contract Management
Chapter 4- Contract ManagementChapter 4- Contract Management
Chapter 4- Contract Management

Job,batch and contract costing
Job,batch and contract costingJob,batch and contract costing
Job,batch and contract costing

3 Type of contracts.pdf
3 Type of contracts.pdf3 Type of contracts.pdf
3 Type of contracts.pdf

Recently uploaded

Call Girls in Nagpur Suman Call 7001035870 Meet With Nagpur Escorts
Call Girls in Nagpur Suman Call 7001035870 Meet With Nagpur EscortsCall Girls in Nagpur Suman Call 7001035870 Meet With Nagpur Escorts
Call Girls in Nagpur Suman Call 7001035870 Meet With Nagpur EscortsCall Girls in Nagpur High Profile

Extrusion Processes and Their Limitations
Extrusion Processes and Their LimitationsExtrusion Processes and Their Limitations
Extrusion Processes and Their Limitations120cr0395

Call for Papers - African Journal of Biological Sciences, E-ISSN: 2663-2187, ...
Call for Papers - African Journal of Biological Sciences, E-ISSN: 2663-2187, ...Call for Papers - African Journal of Biological Sciences, E-ISSN: 2663-2187, ...
Call for Papers - African Journal of Biological Sciences, E-ISSN: 2663-2187, ...Christo Ananth

Microscopic Analysis of Ceramic Materials.pptx
Microscopic Analysis of Ceramic Materials.pptxMicroscopic Analysis of Ceramic Materials.pptx
Microscopic Analysis of Ceramic Materials.pptxpurnimasatapathy1234

(RIA) Call Girls Bhosari ( 7001035870 ) HI-Fi Pune Escorts Service
(RIA) Call Girls Bhosari ( 7001035870 ) HI-Fi Pune Escorts Service(RIA) Call Girls Bhosari ( 7001035870 ) HI-Fi Pune Escorts Service
(RIA) Call Girls Bhosari ( 7001035870 ) HI-Fi Pune Escorts Serviceranjana rawat

Porous Ceramics seminar and technical writing
Porous Ceramics seminar and technical writingPorous Ceramics seminar and technical writing
Porous Ceramics seminar and technical writingrakeshbaidya232001

Structural Analysis and Design of Foundations: A Comprehensive Handbook for S...
Structural Analysis and Design of Foundations: A Comprehensive Handbook for S...Structural Analysis and Design of Foundations: A Comprehensive Handbook for S...
Structural Analysis and Design of Foundations: A Comprehensive Handbook for S...Dr.Costas Sachpazis

Introduction to Multiple Access Protocol.pptx
Introduction to Multiple Access Protocol.pptxIntroduction to Multiple Access Protocol.pptx
Introduction to Multiple Access Protocol.pptxupamatechverse

VIP Call Girls Service Hitech City Hyderabad Call +91-8250192130
VIP Call Girls Service Hitech City Hyderabad Call +91-8250192130VIP Call Girls Service Hitech City Hyderabad Call +91-8250192130
VIP Call Girls Service Hitech City Hyderabad Call +91-8250192130Suhani Kapoor

Sheet Pile Wall Design and Construction: A Practical Guide for Civil Engineer...
Sheet Pile Wall Design and Construction: A Practical Guide for Civil Engineer...Sheet Pile Wall Design and Construction: A Practical Guide for Civil Engineer...
Sheet Pile Wall Design and Construction: A Practical Guide for Civil Engineer...Dr.Costas Sachpazis

main PPT.pptx of girls hostel security using rfid
main PPT.pptx of girls hostel security using rfidmain PPT.pptx of girls hostel security using rfid
main PPT.pptx of girls hostel security using rfidNikhilNagaraju

What are the advantages and disadvantages of membrane structures.pptx
What are the advantages and disadvantages of membrane structures.pptxWhat are the advantages and disadvantages of membrane structures.pptx
What are the advantages and disadvantages of membrane structures.pptxwendy cai

Software Development Life Cycle By Team Orange (Dept. of Pharmacy)
Software Development Life Cycle By  Team Orange (Dept. of Pharmacy)Software Development Life Cycle By  Team Orange (Dept. of Pharmacy)
Software Development Life Cycle By Team Orange (Dept. of Pharmacy)Suman Mia

MANUFACTURING PROCESS-II UNIT-2 LATHE MACHINE
MANUFACTURING PROCESS-II UNIT-2 LATHE MACHINEMANUFACTURING PROCESS-II UNIT-2 LATHE MACHINE
MANUFACTURING PROCESS-II UNIT-2 LATHE MACHINESIVASHANKAR N

The Most Attractive Pune Call Girls Budhwar Peth 8250192130 Will You Miss Thi...
The Most Attractive Pune Call Girls Budhwar Peth 8250192130 Will You Miss Thi...The Most Attractive Pune Call Girls Budhwar Peth 8250192130 Will You Miss Thi...
The Most Attractive Pune Call Girls Budhwar Peth 8250192130 Will You Miss Thi...ranjana rawat

(MEERA) Dapodi Call Girls Just Call 7001035870 [ Cash on Delivery ] Pune Escorts
(MEERA) Dapodi Call Girls Just Call 7001035870 [ Cash on Delivery ] Pune Escorts(MEERA) Dapodi Call Girls Just Call 7001035870 [ Cash on Delivery ] Pune Escorts
(MEERA) Dapodi Call Girls Just Call 7001035870 [ Cash on Delivery ] Pune Escortsranjana rawat

(SHREYA) Chakan Call Girls Just Call 7001035870 [ Cash on Delivery ] Pune Esc...
(SHREYA) Chakan Call Girls Just Call 7001035870 [ Cash on Delivery ] Pune Esc...(SHREYA) Chakan Call Girls Just Call 7001035870 [ Cash on Delivery ] Pune Esc...
(SHREYA) Chakan Call Girls Just Call 7001035870 [ Cash on Delivery ] Pune Esc...ranjana rawat

High Profile Call Girls Nagpur Isha Call 7001035870 Meet With Nagpur Escorts
High Profile Call Girls Nagpur Isha Call 7001035870 Meet With Nagpur EscortsHigh Profile Call Girls Nagpur Isha Call 7001035870 Meet With Nagpur Escorts
High Profile Call Girls Nagpur Isha Call 7001035870 Meet With Nagpur Escortsranjana rawat

Recently uploaded (20)

Call Girls in Nagpur Suman Call 7001035870 Meet With Nagpur Escorts
Call Girls in Nagpur Suman Call 7001035870 Meet With Nagpur EscortsCall Girls in Nagpur Suman Call 7001035870 Meet With Nagpur Escorts
Call Girls in Nagpur Suman Call 7001035870 Meet With Nagpur Escorts

Extrusion Processes and Their Limitations
Extrusion Processes and Their LimitationsExtrusion Processes and Their Limitations
Extrusion Processes and Their Limitations

Call for Papers - African Journal of Biological Sciences, E-ISSN: 2663-2187, ...
Call for Papers - African Journal of Biological Sciences, E-ISSN: 2663-2187, ...Call for Papers - African Journal of Biological Sciences, E-ISSN: 2663-2187, ...
Call for Papers - African Journal of Biological Sciences, E-ISSN: 2663-2187, ...

Microscopic Analysis of Ceramic Materials.pptx
Microscopic Analysis of Ceramic Materials.pptxMicroscopic Analysis of Ceramic Materials.pptx
Microscopic Analysis of Ceramic Materials.pptx

(RIA) Call Girls Bhosari ( 7001035870 ) HI-Fi Pune Escorts Service
(RIA) Call Girls Bhosari ( 7001035870 ) HI-Fi Pune Escorts Service(RIA) Call Girls Bhosari ( 7001035870 ) HI-Fi Pune Escorts Service
(RIA) Call Girls Bhosari ( 7001035870 ) HI-Fi Pune Escorts Service

Porous Ceramics seminar and technical writing
Porous Ceramics seminar and technical writingPorous Ceramics seminar and technical writing
Porous Ceramics seminar and technical writing

Structural Analysis and Design of Foundations: A Comprehensive Handbook for S...
Structural Analysis and Design of Foundations: A Comprehensive Handbook for S...Structural Analysis and Design of Foundations: A Comprehensive Handbook for S...
Structural Analysis and Design of Foundations: A Comprehensive Handbook for S...

Introduction to Multiple Access Protocol.pptx
Introduction to Multiple Access Protocol.pptxIntroduction to Multiple Access Protocol.pptx
Introduction to Multiple Access Protocol.pptx

VIP Call Girls Service Hitech City Hyderabad Call +91-8250192130
VIP Call Girls Service Hitech City Hyderabad Call +91-8250192130VIP Call Girls Service Hitech City Hyderabad Call +91-8250192130
VIP Call Girls Service Hitech City Hyderabad Call +91-8250192130

DJARUM4D - SLOT GACOR ONLINE | SLOT DEMO ONLINE
DJARUM4D - SLOT GACOR ONLINE | SLOT DEMO ONLINEDJARUM4D - SLOT GACOR ONLINE | SLOT DEMO ONLINE
DJARUM4D - SLOT GACOR ONLINE | SLOT DEMO ONLINE

Sheet Pile Wall Design and Construction: A Practical Guide for Civil Engineer...
Sheet Pile Wall Design and Construction: A Practical Guide for Civil Engineer...Sheet Pile Wall Design and Construction: A Practical Guide for Civil Engineer...
Sheet Pile Wall Design and Construction: A Practical Guide for Civil Engineer...

main PPT.pptx of girls hostel security using rfid
main PPT.pptx of girls hostel security using rfidmain PPT.pptx of girls hostel security using rfid
main PPT.pptx of girls hostel security using rfid

What are the advantages and disadvantages of membrane structures.pptx
What are the advantages and disadvantages of membrane structures.pptxWhat are the advantages and disadvantages of membrane structures.pptx
What are the advantages and disadvantages of membrane structures.pptx

Software Development Life Cycle By Team Orange (Dept. of Pharmacy)
Software Development Life Cycle By  Team Orange (Dept. of Pharmacy)Software Development Life Cycle By  Team Orange (Dept. of Pharmacy)
Software Development Life Cycle By Team Orange (Dept. of Pharmacy)

MANUFACTURING PROCESS-II UNIT-2 LATHE MACHINE
MANUFACTURING PROCESS-II UNIT-2 LATHE MACHINEMANUFACTURING PROCESS-II UNIT-2 LATHE MACHINE
MANUFACTURING PROCESS-II UNIT-2 LATHE MACHINE

9953056974 Call Girls In South Ex, Escorts (Delhi) NCR.pdf
9953056974 Call Girls In South Ex, Escorts (Delhi) NCR.pdf9953056974 Call Girls In South Ex, Escorts (Delhi) NCR.pdf
9953056974 Call Girls In South Ex, Escorts (Delhi) NCR.pdf

The Most Attractive Pune Call Girls Budhwar Peth 8250192130 Will You Miss Thi...
The Most Attractive Pune Call Girls Budhwar Peth 8250192130 Will You Miss Thi...The Most Attractive Pune Call Girls Budhwar Peth 8250192130 Will You Miss Thi...
The Most Attractive Pune Call Girls Budhwar Peth 8250192130 Will You Miss Thi...

(MEERA) Dapodi Call Girls Just Call 7001035870 [ Cash on Delivery ] Pune Escorts
(MEERA) Dapodi Call Girls Just Call 7001035870 [ Cash on Delivery ] Pune Escorts(MEERA) Dapodi Call Girls Just Call 7001035870 [ Cash on Delivery ] Pune Escorts
(MEERA) Dapodi Call Girls Just Call 7001035870 [ Cash on Delivery ] Pune Escorts

(SHREYA) Chakan Call Girls Just Call 7001035870 [ Cash on Delivery ] Pune Esc...
(SHREYA) Chakan Call Girls Just Call 7001035870 [ Cash on Delivery ] Pune Esc...(SHREYA) Chakan Call Girls Just Call 7001035870 [ Cash on Delivery ] Pune Esc...
(SHREYA) Chakan Call Girls Just Call 7001035870 [ Cash on Delivery ] Pune Esc...

High Profile Call Girls Nagpur Isha Call 7001035870 Meet With Nagpur Escorts
High Profile Call Girls Nagpur Isha Call 7001035870 Meet With Nagpur EscortsHigh Profile Call Girls Nagpur Isha Call 7001035870 Meet With Nagpur Escorts
High Profile Call Girls Nagpur Isha Call 7001035870 Meet With Nagpur Escorts

Construction practices

  • 2. TYPES OF CONTRACT 1. Lump Sum Construction Contract  In this type the contractor bids a single fixed price for overall activities in the project scope.  The contractor is responsible for estimating project costs from drawings then adds overhead and his profit to determine the price of the project.  All risks are assigned to the contractor, there isn’t any risk carried by the owner.  The contractor has incentive in this contract as he is rewarded for early finish and there is penalty for late finish. This contract is ideal when the project scope is well defined at the design stage because there is limited flexibility for modifying the design during construction period.
  • 3. 2.PIECE WORK CONTRACT Contract for which only a rate is agreed upon without reference to the total quantity of work to be done or the quantity of work to be done within a given period Advantages:  This direct relationship between the results of labor and remuneration is a real advantage of the piecework form of payment.  The employer’s interests are successfully met because, without additional control, employees are interested in increasing the company’s production. Disadvantages: 1)Neglecting external factors. 2) Losing quality for the sake of quantity
  • 4. 3. Unit Price contract  Contractor under takes the work at the unit rates agreed at the time of the tender.  Payment made to contractor after measurement of work done Ex: Maintenance of building, irrigation projects such as canal. Merits: 1. Since work is distributed item wise there will no dispute between contractor and owner 2. Drawing and Specs can be changed at any instant. 3. Bills paid after measurement of actual work. Hence economical. Demerits: 1. Final cost can not be determined before completion of work. 2. Comparative statement of item rate tenders is more complicted hence needs expert srutiny
  • 5. 4. Cost plus percentage contract:  In this contractor gets paid actual cost of the building PLUS a fixed percentage for his overhead expenses, services and profit.  Contractor procures the materials and other recourses and does all the work required and maintains a proper account and he is paid by the department or owner (cost + 10% Normally) Merits: 1. The would be no chance of dispute for carrying out extra item of works. 2. Contractor is free to take decision independently hence quick completion is possible. Demerits: 1. Final cost can not be determined before completion of work. 2. Quality of work may be poor. 3. Very difficult to determine the actual cost incurred by the contractor.
  • 6. 5. Labour contract:  In this contractor under takes only labour portion of the work.  All the necessary materials are supplied by the department or owner.  Contractor gets paid for the labours only based on the measurement of the works done.  Merits: 1. Materials stored by the department are used effectively. 2. Materials are supplied by the department hence quality can be expected. Demerits: 1. There may be delay in obtaining the materials by the department. 2. Large storage is required to store different materials. 3. Theft from stores, shortage of materials, accounting all the materials are constant worries to the department or owner
  • 7. 6. Negotiated contract: When the work is awarded on the contract by manual negotiation between the parties without call of tenders it is said to be negotiated contract. PWD Negotiated contracts are initiated only under special circumstance a) To obtain reasonable rates. b) To meet the situation arising out of emergency. Example: Construction of shelter for displaced people, strengthening runway for national defence
  • 8. Point of Differentiation Lump Sum Contract Unit Price Contract Cost Plus Contract Piece work Contract Advantages with respect to the contractor Incentives for early finish Low risk No risk Rewards for any savings between actual and target cost Disadvantages with respect to the contractor High risk No incentives for early finish No incentives for early finish Share risk with the owner Advantages with respect to the owner No risk Share risk with the contractor Can start project without finishing designs Target cost is defined at early stagesTotal cost is defined at early stages Disadvantages with respect to the owner Contractor desire to decrease costs may be to detriment of quality Total cost is uncertain at early stages High risk Share risk with the contractor Total cost is uncertain at early stages Flexibility of design changing Limited flexibility Has flexibility to change design More flexible to design stages Limited flexibility
  • 9. General Condition of contract: 1. The rates agreed by the contractor should be inclusive of transport,materials,labours,tools,plants and all other necessary arrangements. 2. The contractor should deposit 10% of the cost of the work as a security deposit the contractor may deposit the entire amount at the beginning of the project or can be deducted from the running bills contractor 3. The contractor should complete the work within specified time otherwise he is liable for the penalty 4. The time may be extended by the department for the valid reasons requested by the contractor 5. The cost of the material issued to the contractor equipment given to the contractor shall be deducted from his running bills
  • 10. General Condition of contract: 6. The work has to be play according to the drawings, plan specifications and order issued by the authority. 7. The contractor terminated for his bad work or unsatisfactory progress and the part or full security deposit may be forfeited. 8. the work shall be open for inspection. 9. extra items which are not included in the contract shall be paid as per the current schedule of rates. 10. compensation to the workman shall be paid by the contractor for any accident or damage. 11. All the taxes, royalties etc. Shall have to be paid by the contractor whiche are included in the rates
  • 11.
  • 12. Contract Agreement: Contract agreement is written document binding legally the contractor and the department to follow the rules and regulations. All the pages of the agreement must be signed by both parties. Contract agreement must be containing following details. 1) Title page with name of the work and contract number. 2)Index page giving the content of the agreement the page preferences 3) tender notice with description of work, location time, period of completion etc
  • 13. Contract Agreement (continued…): 4) bill of quantities and total cost of the work etc 5) schedule of issue of materials giving list of materials to be issued with rate and place of issue 6) general specification during the classes and type of work. 7) detailed specification for the each item of work and materials. 8) complete Drawings with plan, elevation, site plan and other relevant details. 9) condition of contract giving rate of labour, materials, tools and plants, progress rate etc. 10) special conditions regarding nature of work, taxes, royalties, labour and amenities etc Contract Agreement:
  • 14. Tender: Tender is an offer in writing to execute some specified work or to supply the materials at certain prices within a fixed time under the certain conditions of agreement between the contractor and the owner Necessity of tenders: 1. Lower bids may be obtained due to competition. 2. Contractors experience can be utilised. 3. Partiality, Personal interest,Prejudices,can be avoided
  • 15. Tender Form: Tender form is a printed standard form of contract giving standard conditions of contract, general rules and directions for the contractors 1. General work description. 2. Estimated cost. 3. EMD(Earnest Money Deposit) 4. SD(Security Deposit) 5. Time allowed for the work from date of written order to commence 6. Column for sign of contractor before submission of tender and sign of officer by whom accepted
  • 16. Tender Document: Content of tender document 1) detailed specification of the work material should be used. 2) A complete set of Drawings with detail of various parts. 3) general conditions of contract 4) special conditions of contract. 5) schedule of quantities the various terms of work. Approximate qnty of work under each item of work. 6) the location of the work 7) the name of the division in which work is situated. 8) the rates of the Steel and cement if they are supplied by the department.
  • 17. Tender Document: 9) Hire charges for the lorries, plants to be levied when issued from the department 10) condition regarding employment of the technical personnel. 11) location of water location point and supply point of power. 12) the period of completion of work and the time required for each item of work. 13) the amount of earnest money deposit (EMD). 14) the name of authority that is accepting or rejecting the tender. 15) conditions of penalty for slow progress and non fulfilment of the condition of the contract. 16) resolution for the dispute.
  • 18. Tender Notice: After approval of tender document by the concern authority inviting tender has to be published on the notice board and all units of the department and advertisement in the press and by the notice in English/ Hindi newspapers.
  • 19. Following particulars should be written in the tender notice: 1) name of the authority inviting the tender. 2) name of the work and it's location. 3) estimated cost of the work. 4) period and type of contract. 5) when and where the tender document should be purchased. 6) tender schedule. 7) the amount of EMD and SD 8) open timing of the tender opening. 9) designation of the officer who accepts the tender.
  • 20. Preparing comparative statement of tender Once after the tender opens comparative statements should be prepared it serves the rates of different builders normally lowest will be a successful bidder hands become the contractor
  • 21. Scrutiny of tender: Tender inviting authority should verify the terms and conditions of the tender has been obeyed are not or any special conditions are special addendums added or not and hence calculate the consequent deviations. After the detailed scrutiny the tender document along with comparative statement will be sent to next higher authorities stating his observation and recommendations.
  • 22. Acceptance of Tender: Based on the comparative statement usually the lowest tender is accepted except In the case where the lowest tender black mark in his work. Tenderer whose rates are accepted is intimated to sign the contract documents. If he fail to sign the contract document within specified time then his tender will be cancelled and his EMD will be forfeited. Tender may be allotted to the next lowest bidder.
  • 23. Execution of contract agreement: After acceptance of tender and contract documents. contractor required to pay security deposit before contract agreement is signed. Earnest money deposit(EMD): when the contractor submits the tender to any work, he have to deposit some amount usually 2% of the estimated cost to the department as the guarantee of tender. When contractor refuses to take work after the acceptance of tender then the EMD will be forfeited. But EMD of all other Unsuccessful bidders will be returned.
  • 24. Security deposit (SD):  when tender is accepted the contractor has to deposit 10% of the project cost as a security deposit. This amount includes EMD, contractor can pay the entire amount or the it can be deducted from the running bills.  Contractor should fulfil all the terms and conditions of the tender specifications, quality of the work, within specified time. if he fails to fulfil then security deposit would be forfeited partially or fully  if he completes the work satisfactorily amount will be refunded to the contractor after six months. during this period there should not be any defects.
  • 25. work order: for petty and small works Site order book: Within 10 days of acceptance of the work order contractor should submit a site order book subdivision assistant engineer in triplicates. which should be machine Numbered.
  • 27. Advantages of e tendering 1. Reduced tender cycle-time. 2. Fast and accurate pre-qualification and evaluation, which enables the automatic rejection of suppliers that fail to meet the tender specification. 3. Faster response to questions and points of clarification during the tender period. 4. Reduction in the labour intensive tasks of receipt, recording and distribution of tender submissions.
  • 28. Advantages of e tendering 4.Reduction in the labour intensive tasks of receipt, recording and distribution of tender submissions. 5. Reduction of the paper trail on tendering exercises, reducing costs to both councils and Suppliers. 6.Improved audit trail increasing integrity and transparency of the tendering process. 7. Improved quality of tender specification and supplier response. 8. Provision of quality management information
  • 29. Penalty on contractor: slow progress: For slow progress contractor may be penalised with 1% of the cost of the construction per week and should not exceed 10% cost of contract. damages: if contractor uses department equipment. repair or replacement of equipment or plants should be done. Termination of contract: The executive Engineer or the competent authority is empowered to terminate the contract in case of the bankruptcy or default of contractor an amount up to 10% estimated cost is forfeited if the contract is to be terminated a notice to that effect has to be serves to the contractor.
  • 30. Termination of contract: The contract agreement may be terminated in the following conditions: Bankruptcy : If both or one of the parties become bankrupt the contract may be terminated since the work cannot be completed due to lack of funds. Breach of conditions : If one party fails to follow the conditions mentioned in the contract then the other party has every right to terminate the contract and can also claim for damages done to him through court of law or through arbitration
  • 31. Agreement: Due to extraordinary circumstances it may become necessary to terminate the contract by mutual agreement. For example the owner or contractor may expire and no other person may be there to fulfil the agreement. Completion of the work: If the work is completed satisfactorily as per the conditions in the agreement then also the contract is terminated after making the final payment to the contractor and releasing his security deposit.
  • 32. MUSTER ROLL muster roll is a record, in which names, particulars and attendance of daily labourers, payable to-them and the work done by them are recorded. The advance for payment to the labour is issued on the basis of muster roll and after disbursement of wages and recording necessary certificates of disbursement is kept as a voucher. In muster roll form the record of the attendance of labourers, payments and work done by them are recorded
  • 33. Rules for preparing muster roll: 1 . One or more muster rolls can be used for the same work. 2. Muster rolls should never be prepared in duplicate for the same work. 3. The presence of labour should be marked with a cross mark (X) and the absence, with letter A 4. Labourers may be paid more than once a month depending upon local conditions, but after each payment, separate or new muster roll has to be opened. 5. The daily record of attendance and fines should be recorded. 6. After the muster roll has been passed, payment should be made as early as possible by the sub-divisional officer in the presence of subordinate concerned, who should certify to the payment as "paid in my presence to the right person".
  • 34. common irregularities in the master rolls: 1. The labourers employed on muster roll not grouped. 2. Muster rolls contain erasures and over writings. 3. Muster rolls not signed daily. Muster rolls should be signed daily by the person who mark the daily attendance. 4. Attendance is not marked daily. The attendance of the muster roll labourer should be marked daily.
  • 35. common irregularities in the master rolls: 5. Discrepancy between the daily report and muster roll. The details of labour given in daily labour report and muster roll should tally. Any difference between the two is highly objectionable. 6. Corrections not attested. Any correction made in the muster roll should be attested with the dated initials of the person who makes it. 7. Delay in passing the muster roll and its payment.
  • 36. LABOUR REPORT This report gives the following information's. 1) Category or class of labourers such as mason, carpenter, etc. 2)Number of labourers employed in each category. 3) Rates at which labourer employed. 4)Approximate amount of work done, etc.
  • 37. MEASUREMENT BOOK(MB) It is a book which records the measurement of all the works and supply of materials for the purpose of payment. all measurement books are serially numbered and pages of each book are machine numbered. The register of measurement book is maintained in Divisional Office showing the serial number of each book, name of the Sub-Division to which it is issued. The date of its issue and date of its return to the divisional Office also will be recorded in the register. The loss of measurement book is the serious matter which should be reported to the higher officer and the person responsible will be punished
  • 38. Importance of MB 1)MB is initial record for all kinds of works. 2)MB are the basis for all kinds of account of quantities. 3)MB must be accurate and kept carefully
  • 39. Kinds of Measurement Books: 1) Ordinary measurement book. 2)Standard Measurement book 3)Check measurement Book
  • 40. Kinds of Measurement Books: 1) Ordinary measurement book: It is an initial record of all kinds of works which are susceptible to measurements. In this book entries regarding the work done, supplies made are recorded for the purpose of making payments to the contractors. 2) Standard measurement book In the department there are some buildings which are repaired periodically and the quantities of various items of work remain same from year to year. In such cases of repair works to save the trouble of measuring them every time, it is convenient to maintain standard measurement books of such buildings. Thus the measurement book in which standard measurements are recorded is known as standard measurement book. preparation of estimate for periodical repairs, white washing, color washing, etc. The standard measurement book is checked every year.
  • 41. Kinds of Measurement Books: Advantages of standard measurement book are: 1. It facilitate the preparation of estimates for repair work from time to time. 2. It simplifies the preparation of the contractor's bill as it is not necessary to take detailed measurement. 3. Check measurement book
  • 42. Kinds of Measurement Books: 3)Check measurement Book To check the measurements made by the Sectional Officer or Junior Engineer a check measurement book is kept by the Sub Divisional officer. Some portions of the measurement which are recorded by section officer will be checked by AE and EE in presence of Section officer. AEE checks 25%and EE can check 8- 50% of each subdivision in case of civil works difference should not exceed 17% Earth work 10% repair 5% if exceeded then it has to be escalated to the higher officer.
  • 43. IRREGULARITES IN WRITING MEASUREMENT BOOK 1. Agreement number is not written on the top of the measurements. 2. over writing and erasing original entry 3. Entries in the measurement book interpolated and corrected and the amount of the bill is also changed after the original preparation of the bill. 4. Blank spaces shouldn't be left in pagea 5. Entries in the measurement book are not recorded at the site of work, but copied from some other record 6. Entries originally are made in pencil and inked over afterwards. 7. Full particulars of work are not given and the name of the work does not tally with the sanctioned estimate. 8. Payments are made without the sub-divisional, officer's pay order or the clerk's certificate of check.
  • 44. IRREGULARITES IN WRITING MEASUREMENT BOOK 9. Percentage of checks by senior officers is inadequate. 10. Corrections are not attested. 11. Voucher number and date not indicated after making the payment. 12. Index of the measurement book is not up to-date.
  • 45. IRREGULARITES IN WRITING MEASUREMENT BOOK 9. Percentage of checks by senior officers is inadequate. 10. Corrections are not attested. 11. Voucher number and date not indicated after making the payment. 12. Index of the measurement book is not up to-date. PAYMENT OF BILLS Bill: It is the account of work done or materials supplied. It contains full particulars lika! amount, amount due and agreement number is also mentioned. Voucher: It is a return document as a proof of payment.
  • 46. TYPES OF BILLS Four types of bill forms are used depending upon the mode of contract. 1. First and Final Bill This form of bill is used for making payment to contractors both for works done or supplies received, when a single payment is made for a job or a contract on its completion. 2. Running Account Bill This form is used for contracts both for works executed on piece-work system and for received This bill is prepared for 1) Value of measured items of work 2) Value of authorized extra work on account of additional works
  • 47. TYPES OF BILLS 3. Lumpsum Contract Bill In the Lumpsum contract method, a number of intermediate payments.ie advance pay are made in Lumpsum contract running-account bill form before final payment. ount bill-form before final payment is made. 4) Hand Receipt. this is an simple voucher which is used for the small and petty works
  • 48. Mode of payments 1) Mobilization Advance- mobilise Resources 2) First and Final Payment- applicable for small works 3)Final payment - Running account bill after completion of work 4) intermediate Payment- after part work completion 5) Advance - work has sufficient progress. 6) secured Advance - Divisional officer may sanction advance at the rate of 70% of value of materials which are brought to site
  • 49. checking of Bills before signing the bill the sub divisional officers or AEE should check the following deduction have made and compare bills . 1) Recovery of Advance payments. 2) Recovery in respect of department material used . 3) Hiring charges for department tools and plants. 4) The amount to be with held towards SD 5) Penalty and slow progress 6) Recovery towards empty bags not return.
  • 50. checking of Bills before signing the bill the sub divisional officers or AEE should check the following deduction have made and compare bills . 1) Recovery of Advance payments. 2) Recovery in respect of department material used . 3) Hiring charges for department tools and plants. 4) The amount to be with held towards SD 5) Penalty and slow progress 6) Recovery towards empty bags not return.
  • 51. PASSING AND PAYMENT OF BILLS -after checking bills arithmetic check, accuracy and compare with contractors ledger -memorandum of payment is made -officer shall pass Bill on the basis of MB and cross out it. - the contractor is paid for the net ammount and by cheque and acknowledgement taken for Gross ammt
  • 52. ESCALATION: In case of Big projects, later stage of project may face price increase in construction materials hence such statements are included in tender document to escalate if the prices of materials like cement, aggregate and steel etc goes up. HINDRANCE REGISTER: hindrance caused by contractor or owner or by third parties and major forces are to be recorded in a register called hindrance register. This is the reliable document to decide on extension of time .
  • 53. Drawing Register: This register maintained list out drawing relating to the project. COMPLETION REPORT When a work is completed and the accounts have been settled, a note below the final entries is made in red ink. Work completed on ______ date and this note is signed by divisional officer. with notes and orders And Project competition certificate is issued in a standard format .
  • 54. Principles to be followed in PWD system  All transaction is, whether income or expenditure have to be passed through certain specified heads  everything should be done with certain procedures and rules and regulations responsibility is laid on divisional officer. and should be under certain heads of account. 1) Expenditure heads. 2) Revenue Heads 3) Remittance head 4) Debit or depository heads
  • 55. IMPREST & TEMPORARY ADVANCE Imprest is a standing advance of fixed sum of money given to Sub- divisional to enable them carry out day to day petty payments for proper discharge of their duties either in cash or in the form of voucher.( Without bills) Temporary advances These are granted to Sub-Divisional Officer for making specific payments on bills or Muster rolls, etc
  • 56. CASH BOOK The cash book is one of the most important account records of the division.  It is maintained in form-1 for all cash transactions for day-to-day, strictly in order of occurrence. The detailed instructions are available in the fly leaf of the cash book. The pages of the cash book are machine numbered
  • 57. CONTRACTOR'S LEDGER For every contractor a separate Register is maintained at sub divisional office in this ledger all the details of the contractor and payments, recoveries adjustments are noted in a prescribed format.
  • 58. Stores Management: STORE : it is a place that keeps the materials in a way by which the materials are well accounted for, are maintained safe, and are available at the time of requirement.
  • 59. Stores Management: STORE : it is a place that keeps the materials in a way by which the materials are well accounted for, are maintained safe, and are available at the time of requirement. Classification of stores 1)Stock or general stores 2)Tools and plants 3) Materials charged direct to work 4)Road metals
  • 60. 1)stock or General Stores Department keeps all the necessary construction materials to avoid delay
  • 61. Sub heads are 1) small stores : nails , screws nuts bolts etc 2) Building materials : cement brick steel etc 3) timber: teak wood etc 4) Metals : iron rolled, sections etc 5) fuel and lubricants coal petrol 6) Painter store: paints brush etc 7) House fittings 8) Miscellaneous store : pipes empty drums etc 9) Manufacture
  • 62. 2) Tools and plants 1) General or ordinary tools and plants 2) Special tools and plants Sub heads of Tools and plants: 1) Plants and machinery- fixed, movable, locomotive, vehicles,road making 2) Tools -Fixed(lathe), saw drills etc 3) Scientific apparatus and instruments-pippet , thermometer, breakers, surveying instruments- chain tape theodolite,total station etc
  • 63. 2) Tools and plants 1) General or ordinary tools and plants 2) Special tools and plants Sub heads of Tools and plants:  Furniture- office chair , office tables,waste paper basket etc  Hospital equipment-furntures dentist chairs , xray plants etc  Live stock - bullock, horses etc
  • 64. Maintenance of stores Points to be considered for storages of materials 1) Combustible materials should be kept separately to avoid fire accidents. 2) oil should be stored in seperate store over the sand 3) petroleum should be stored in under ground tanks.
  • 65. Maintenance of stores 4) Textile material should be protected from attack of insects 5)coal charcoal should be stored in bins 6)all iron and steel should be grouped as per size 7)Road metals are stores on level ground.
  • 66. 8)canvas material should be exposed to sunlight and dried often . 9)all wood items should be periodically examined and preventive measures should be taken. ISSUES: The materials are issued from stocks for following 1)Either for direct use or for contractors use 2)For sale to contractor or to the other person 3) transfer to other stores within division 4)For dispatch to other departments
  • 67. Indent: issue of materials from stock should be made only on the receipt of an indent in a quadruplicate signed by divisional or sub divisional officer.entry of materials should be made in all four copies of indent. One copy with store keeper himself One copy returned to the indenting officers Third and fourth copy sent to divisional officer
  • 68. Invoice: The invoice is available in tge standard format which should be filled up when the materials are to be supplied.It should be sent along with the materials to the indenting officers for his acknowledgements. Indenting officers should sign and return it to the store keeper. Invoice should be in triplicates One original will be in invoice book 2 will be sent to divisional officer.
  • 69. Bin card: In stores, a number of materials are to be handled. Details of information about the stock position,drawel rate per month, when the order of perticular material is placed are all entered on bin card . Specimen of Bin card:
  • 70. Inspection of stores: # Verification of materials should be made in the presence of the authority responsible. # Ending 31st March and 30th September in the same manner as stated. # Tools and plants, stocks should be done every six months.
  • 71. Inspection of Stores Storage and surplus Shortage of stores Materials at site account (MAS)
