Time-Cost
              Trade-Off



                Time-Cost Trade-Off
         Duration and cost of activity depends on the amount an type

         of resources used

         Assuming more workers will normally reduce time and will

         change its cost

         This relationship between activity time and cost called


         time-cost Trade off


04/11/2006                     Emad Elbeltagi                       2




                                                                        1
Time-Cost Trade-Off
Why do we need to reduce project time?

       Finish the project in a predefined deadline date

       Recover early delays to avoid liquidated damages

       Free key resources early for other projects

       Avoid adverse weather conditions that might affect productivity

       Receive an early completion-bonus

       Improve project cash flowscheduling techniques are duration




04/11/2006                    Emad Elbeltagi                         3




               Time-Cost Trade-Off
What is the way to reduce activity duration?

       Working extended hours (Over time)

       Offering incentive payments to increase the productivity

       Using additional resources

       Using materials with faster installation methods

       Using alternate construction methods or sequence




04/11/2006                    Emad Elbeltagi                         4




                                                                         2
Time-Cost Trade-Off
Activity Time-Cost Relationship

         Decreasing activity duration will increase its cost

             Cost


                            Crash duration
                                  &
                              Crash cost




                                                       Normal duration
                                                             &
                                                         Normal cost

                                                                  Time



04/11/2006                            Emad Elbeltagi                      5




                    Time-Cost Trade-Off
Activity Time-Cost Relationship


             Cost    Crash duration
                           &
                       Crash cost




                                                        Normal duration
                                                              &
                                                          Normal cost



                                                               Time


04/11/2006                            Emad Elbeltagi                      6




                                                                              3
Time-Cost Trade-Off
Activity Time-Cost Relationship

         For simplicity, linear relationship is adopted

               Cost     Crash duration
                              &
                          Crash cost




                                                                 Normal duration
                                                                       &
                                                                   Normal cost

                                                                                Time




04/11/2006                            Emad Elbeltagi                                    7




                   Time-Cost Trade-Off
Activity Time-Cost Relationship (Example)

         Consider the following options
     Estimated daily
                          Crew size
         production                                      Crew formation
                             (men)
       (square meter)

             166              5           1 scaffold set, 2 labors, 2 carpenter, 1 foreman

             204              6           2 scaffold set, 3 labors, 2 carpenter, 1 foreman

             230              7           2 scaffold set, 3 labors, 3 carpenter, 1 foreman


Consider the following rates: Labor LE 96/day;
carpenter LE 128/day;
foreman LE144/day and
scaffolding LE60/day

04/11/2006                            Emad Elbeltagi                                    8




                                                                                             4
Time-Cost Trade-Off
Activity Time-Cost Relationship (Example)

           8400 Sq meters of scaffolds


  Crew
                       Duration (days)                                  Cost (LE)
   size

    5                    50.6 (use 51)              51 x (1x60 + 2x96 + 2x128 + 1x144) = 33252

    6                    41.2 (use 42)              42 x (2x60 + 3x96 + 2x128 + 1x144) = 33936

    7                    36.5 (use 37)              37 x (2x60 + 3x96 + 3x128 + 1x144) = 34632




04/11/2006                                        Emad Elbeltagi                                 9




                              Time-Cost Trade-Off
Activity Time-Cost Relationship (Example)


                      34800
                                              3
                      34600
                      34400
                      34200
          Cost (LE)




                      34000                              2
                      33800
                      33600
                      33400                                                      1
                      33200
                      33000
                              30         35         40             45       50       55

                                                      Duration (days)



04/11/2006                                        Emad Elbeltagi                                 10




                                                                                                      5
Time-Cost Trade-Off
Project Time-Cost Relationship

         Project direct cost = summation of direct cost of individual

         activities

         Indirect cost comprises site and head office overheads

         Project indirect cost = daily indirect cost x project duration

         Direct cost increases as project duration decreases

         Indirect cost decreases s project duration decreases




04/11/2006                      Emad Elbeltagi                            11




                 Time-Cost Trade-Off
Project Time-Cost Relationship
Project cost




                                                        Project duration



04/11/2006                      Emad Elbeltagi                            12




                                                                               6
Time-Cost Trade-Off

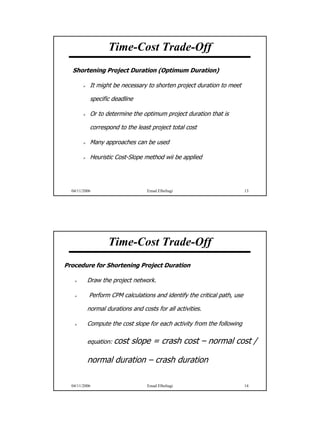

  Shortening Project Duration (Optimum Duration)

           It might be necessary to shorten project duration to meet

           specific deadline

           Or to determine the optimum project duration that is

           correspond to the least project total cost

           Many approaches can be used

           Heuristic Cost-Slope method wii be applied




  04/11/2006                      Emad Elbeltagi                          13




                  Time-Cost Trade-Off

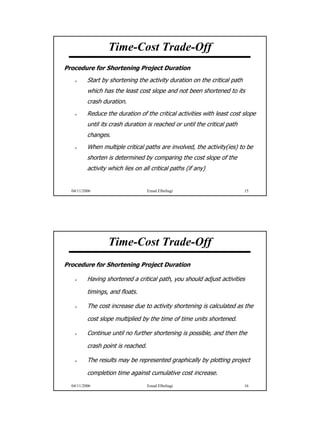

Procedure for Shortening Project Duration

          Draw the project network.

           Perform CPM calculations and identify the critical path, use

          normal durations and costs for all activities.

          Compute the cost slope for each activity from the following

          equation: cost   slope = crash cost – normal cost /

          normal duration – crash duration

  04/11/2006                      Emad Elbeltagi                          14




                                                                               7
Time-Cost Trade-Off
Procedure for Shortening Project Duration
          Start by shortening the activity duration on the critical path
          which has the least cost slope and not been shortened to its
          crash duration.
          Reduce the duration of the critical activities with least cost slope
          until its crash duration is reached or until the critical path
          changes.
          When multiple critical paths are involved, the activity(ies) to be
          shorten is determined by comparing the cost slope of the
          activity which lies on all critical paths (if any)


  04/11/2006                        Emad Elbeltagi                         15




                  Time-Cost Trade-Off
Procedure for Shortening Project Duration

          Having shortened a critical path, you should adjust activities

          timings, and floats.

          The cost increase due to activity shortening is calculated as the

          cost slope multiplied by the time of time units shortened.

          Continue until no further shortening is possible, and then the

          crash point is reached.

          The results may be represented graphically by plotting project

          completion time against cumulative cost increase.
  04/11/2006                        Emad Elbeltagi                         16




                                                                                 8

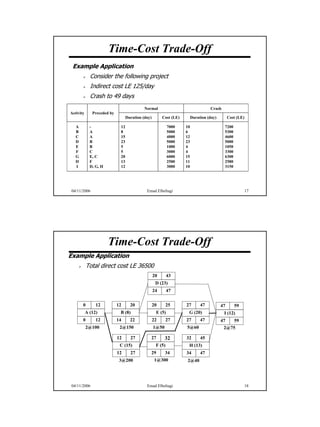

Time-Cost Trade-Off
 Example Application
             Consider the following project
             Indirect cost LE 125/day
             Crash to 49 days
                                            Normal                                 Crash
Activity      Preceded by
                                  Duration (day)        Cost (LE)        Duration (day)        Cost (LE)

   A         -               12                             7000    10                     7200
   B         A               8                              5000    6                      5300
   C         A               15                             4000    12                     4600
   D         B               23                             5000    23                     5000
   E         B               5                              1000    4                      1050
   F         C               5                              3000    4                      3300
   G         E, C            20                             6000    15                     6300
   H         F               13                             2500    11                     2580
   I         D, G, H         12                             3000    10                     3150




 04/11/2006                                  Emad Elbeltagi                                                17




                       Time-Cost Trade-Off
Example Application
           Total direct cost LE 36500
                                                   20       43
                                                    D (23)
                                                   24       47


       0        12          12      20             20       25      27        47          47      59
           A (12)            B (8)                  E (5)            G (20)                I (12)
       0        12          14      22             22     27        27        47          47      59
           2@100             2@150                 1@50             5@60                   2@75

                            12      27         27         32        32        45
                             C (15)                 F (5)            H (13)
                            12      27         29         34        34        47
                             3@200                 1@300            2@40




 04/11/2006                                  Emad Elbeltagi                                                18




                                                                                                                9

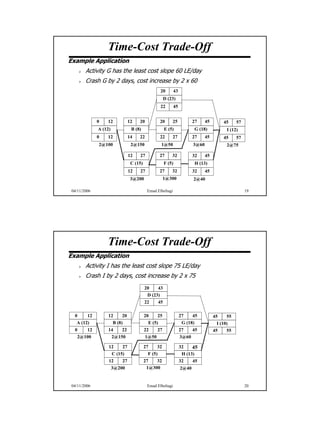

Time-Cost Trade-Off
Example Application
        Activity G has the least cost slope 60 LE/day
        Crash G by 2 days, cost increase by 2 x 60
                                                 20        43
                                                     D (23)
                                                 22        45


              0   12           12   20           20      25            27     45        45     57
              A (12)            B (8)                E (5)             G (18)            I (12)
              0   12           14   22           22      27            27     45        45     57
              2@100             2@150            1@50                  3@60              2@75

                               12   27          27       32            32     45
                                C (15)               F (5)             H (13)
                               12   27          27       32            32     45
                                3@200                1@300             2@40

 04/11/2006                               Emad Elbeltagi                                            19




                  Time-Cost Trade-Off
Example Application
        Activity I has the least cost slope 75 LE/day
        Crash I by 2 days, cost increase by 2 x 75
                                         20    43
                                          D (23)
                                         22    45

  0     12         12     20             20     25              27    45           45     55
   A (12)            B (8)                 E (5)                 G (18)              I (10)
  0   12           14   22               22   27                27   45            45     55
   2@100            2@150                1@50                   3@60

                   12    27              27     32              32    45
                    C (15)                 F (5)                 H (13)
                   12    27              27     32              32    45
                    3@200                 1@300                 2@40


 04/11/2006                               Emad Elbeltagi                                            20




                                                                                                         10

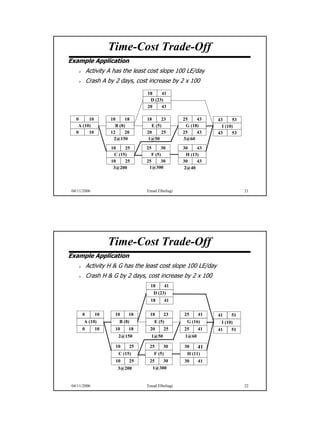

Time-Cost Trade-Off
Example Application
          Activity A has the least cost slope 100 LE/day
          Crash A by 2 days, cost increase by 2 x 100
                                  18    41
                                   D (23)
                                  20    43

   0     10        10     18     18     23        25    43     43     53
    A (10)           B (8)         E (5)           G (18)        I (10)
   0     10        12     20     20     25        25    43     43     53
                    2@150        1@50             3@60
                   10    25      25     30        30    43
                    C (15)         F (5)           H (13)
                   10    25      25     30        30    43
                    3@200         1@300           2@40



 04/11/2006                      Emad Elbeltagi                            21




                   Time-Cost Trade-Off
Example Application
          Activity H & G has the least cost slope 100 LE/day
          Crash H & G by 2 days, cost increase by 2 x 100
                                   18       41
                                    D (23)
                                   18       41

      0       10     10    18      18     23      25      41   41    51
       A (10)          B (8)        E (5)          G (16)       I (10)
      0       10     10    18      20     25      25      41   41    51
                      2@150        1@50            1@60

                     10    25     25      30      30      41
                      C (15)        F (5)          H (11)
                     10    25     25   30         30      41
                      3@200        1@300


 04/11/2006                      Emad Elbeltagi                            22




                                                                                11

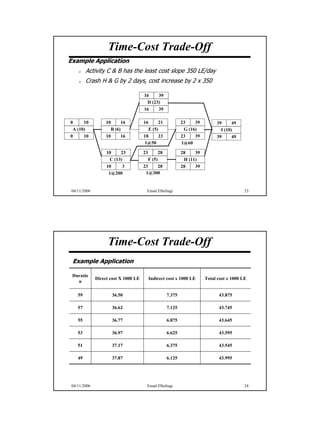

Time-Cost Trade-Off
Example Application
         Activity C & B has the least cost slope 350 LE/day
         Crash H & G by 2 days, cost increase by 2 x 350

                                      16    39
                                       D (23)
                                      16    39

0     10           10     16          16     21                 23    39        39      49
 A (10)              B (6)              E (5)                    G (16)           I (10)
0     10           10     16          18     23                 23    39        39      49
                                      1@50                      1@60

                   10     23          23           28           28    39
                     C (13)                F (5)                 H (11)
                   10      3          23   28                   28    39
                    1@200              1@300


 04/11/2006                            Emad Elbeltagi                                         23




                    Time-Cost Trade-Off
 Example Application

 Duratio
              Direct cost X 1000 LE        Indirect cost x 1000 LE         Total cost x 1000 LE
   n

    59               36.50                              7.375                    43.875

    57               36.62                              7.125                    43.745

    55               36.77                              6.875                    43.645

    53               36.97                              6.625                    43.595

    51               37.17                              6.375                    43.545

    49               37.87                              6.125                    43.995




 04/11/2006                            Emad Elbeltagi                                         24




                                                                                                   12
Time-Cost Trade-Off
Example Application

              50

              40
  LE x 1000



              30

              20

              10

              0
                   48    50   52       54      56   58   60
                                   Time (days)



04/11/2006                     Emad Elbeltagi                 25




                                                                   13

P time-cost

  • 1.
    Time-Cost Trade-Off Time-Cost Trade-Off Duration and cost of activity depends on the amount an type of resources used Assuming more workers will normally reduce time and will change its cost This relationship between activity time and cost called time-cost Trade off 04/11/2006 Emad Elbeltagi 2 1
  • 2.
    Time-Cost Trade-Off Why dowe need to reduce project time? Finish the project in a predefined deadline date Recover early delays to avoid liquidated damages Free key resources early for other projects Avoid adverse weather conditions that might affect productivity Receive an early completion-bonus Improve project cash flowscheduling techniques are duration 04/11/2006 Emad Elbeltagi 3 Time-Cost Trade-Off What is the way to reduce activity duration? Working extended hours (Over time) Offering incentive payments to increase the productivity Using additional resources Using materials with faster installation methods Using alternate construction methods or sequence 04/11/2006 Emad Elbeltagi 4 2
  • 3.
    Time-Cost Trade-Off Activity Time-CostRelationship Decreasing activity duration will increase its cost Cost Crash duration & Crash cost Normal duration & Normal cost Time 04/11/2006 Emad Elbeltagi 5 Time-Cost Trade-Off Activity Time-Cost Relationship Cost Crash duration & Crash cost Normal duration & Normal cost Time 04/11/2006 Emad Elbeltagi 6 3
  • 4.
    Time-Cost Trade-Off Activity Time-CostRelationship For simplicity, linear relationship is adopted Cost Crash duration & Crash cost Normal duration & Normal cost Time 04/11/2006 Emad Elbeltagi 7 Time-Cost Trade-Off Activity Time-Cost Relationship (Example) Consider the following options Estimated daily Crew size production Crew formation (men) (square meter) 166 5 1 scaffold set, 2 labors, 2 carpenter, 1 foreman 204 6 2 scaffold set, 3 labors, 2 carpenter, 1 foreman 230 7 2 scaffold set, 3 labors, 3 carpenter, 1 foreman Consider the following rates: Labor LE 96/day; carpenter LE 128/day; foreman LE144/day and scaffolding LE60/day 04/11/2006 Emad Elbeltagi 8 4
  • 5.
    Time-Cost Trade-Off Activity Time-CostRelationship (Example) 8400 Sq meters of scaffolds Crew Duration (days) Cost (LE) size 5 50.6 (use 51) 51 x (1x60 + 2x96 + 2x128 + 1x144) = 33252 6 41.2 (use 42) 42 x (2x60 + 3x96 + 2x128 + 1x144) = 33936 7 36.5 (use 37) 37 x (2x60 + 3x96 + 3x128 + 1x144) = 34632 04/11/2006 Emad Elbeltagi 9 Time-Cost Trade-Off Activity Time-Cost Relationship (Example) 34800 3 34600 34400 34200 Cost (LE) 34000 2 33800 33600 33400 1 33200 33000 30 35 40 45 50 55 Duration (days) 04/11/2006 Emad Elbeltagi 10 5
  • 6.
    Time-Cost Trade-Off Project Time-CostRelationship Project direct cost = summation of direct cost of individual activities Indirect cost comprises site and head office overheads Project indirect cost = daily indirect cost x project duration Direct cost increases as project duration decreases Indirect cost decreases s project duration decreases 04/11/2006 Emad Elbeltagi 11 Time-Cost Trade-Off Project Time-Cost Relationship Project cost Project duration 04/11/2006 Emad Elbeltagi 12 6
  • 7.
    Time-Cost Trade-Off Shortening Project Duration (Optimum Duration) It might be necessary to shorten project duration to meet specific deadline Or to determine the optimum project duration that is correspond to the least project total cost Many approaches can be used Heuristic Cost-Slope method wii be applied 04/11/2006 Emad Elbeltagi 13 Time-Cost Trade-Off Procedure for Shortening Project Duration Draw the project network. Perform CPM calculations and identify the critical path, use normal durations and costs for all activities. Compute the cost slope for each activity from the following equation: cost slope = crash cost – normal cost / normal duration – crash duration 04/11/2006 Emad Elbeltagi 14 7
  • 8.
    Time-Cost Trade-Off Procedure forShortening Project Duration Start by shortening the activity duration on the critical path which has the least cost slope and not been shortened to its crash duration. Reduce the duration of the critical activities with least cost slope until its crash duration is reached or until the critical path changes. When multiple critical paths are involved, the activity(ies) to be shorten is determined by comparing the cost slope of the activity which lies on all critical paths (if any) 04/11/2006 Emad Elbeltagi 15 Time-Cost Trade-Off Procedure for Shortening Project Duration Having shortened a critical path, you should adjust activities timings, and floats. The cost increase due to activity shortening is calculated as the cost slope multiplied by the time of time units shortened. Continue until no further shortening is possible, and then the crash point is reached. The results may be represented graphically by plotting project completion time against cumulative cost increase. 04/11/2006 Emad Elbeltagi 16 8
  • 9.
    Time-Cost Trade-Off ExampleApplication Consider the following project Indirect cost LE 125/day Crash to 49 days Normal Crash Activity Preceded by Duration (day) Cost (LE) Duration (day) Cost (LE) A - 12 7000 10 7200 B A 8 5000 6 5300 C A 15 4000 12 4600 D B 23 5000 23 5000 E B 5 1000 4 1050 F C 5 3000 4 3300 G E, C 20 6000 15 6300 H F 13 2500 11 2580 I D, G, H 12 3000 10 3150 04/11/2006 Emad Elbeltagi 17 Time-Cost Trade-Off Example Application Total direct cost LE 36500 20 43 D (23) 24 47 0 12 12 20 20 25 27 47 47 59 A (12) B (8) E (5) G (20) I (12) 0 12 14 22 22 27 27 47 47 59 2@100 2@150 1@50 5@60 2@75 12 27 27 32 32 45 C (15) F (5) H (13) 12 27 29 34 34 47 3@200 1@300 2@40 04/11/2006 Emad Elbeltagi 18 9
  • 10.
    Time-Cost Trade-Off Example Application Activity G has the least cost slope 60 LE/day Crash G by 2 days, cost increase by 2 x 60 20 43 D (23) 22 45 0 12 12 20 20 25 27 45 45 57 A (12) B (8) E (5) G (18) I (12) 0 12 14 22 22 27 27 45 45 57 2@100 2@150 1@50 3@60 2@75 12 27 27 32 32 45 C (15) F (5) H (13) 12 27 27 32 32 45 3@200 1@300 2@40 04/11/2006 Emad Elbeltagi 19 Time-Cost Trade-Off Example Application Activity I has the least cost slope 75 LE/day Crash I by 2 days, cost increase by 2 x 75 20 43 D (23) 22 45 0 12 12 20 20 25 27 45 45 55 A (12) B (8) E (5) G (18) I (10) 0 12 14 22 22 27 27 45 45 55 2@100 2@150 1@50 3@60 12 27 27 32 32 45 C (15) F (5) H (13) 12 27 27 32 32 45 3@200 1@300 2@40 04/11/2006 Emad Elbeltagi 20 10
  • 11.
    Time-Cost Trade-Off Example Application Activity A has the least cost slope 100 LE/day Crash A by 2 days, cost increase by 2 x 100 18 41 D (23) 20 43 0 10 10 18 18 23 25 43 43 53 A (10) B (8) E (5) G (18) I (10) 0 10 12 20 20 25 25 43 43 53 2@150 1@50 3@60 10 25 25 30 30 43 C (15) F (5) H (13) 10 25 25 30 30 43 3@200 1@300 2@40 04/11/2006 Emad Elbeltagi 21 Time-Cost Trade-Off Example Application Activity H & G has the least cost slope 100 LE/day Crash H & G by 2 days, cost increase by 2 x 100 18 41 D (23) 18 41 0 10 10 18 18 23 25 41 41 51 A (10) B (8) E (5) G (16) I (10) 0 10 10 18 20 25 25 41 41 51 2@150 1@50 1@60 10 25 25 30 30 41 C (15) F (5) H (11) 10 25 25 30 30 41 3@200 1@300 04/11/2006 Emad Elbeltagi 22 11
  • 12.
    Time-Cost Trade-Off Example Application Activity C & B has the least cost slope 350 LE/day Crash H & G by 2 days, cost increase by 2 x 350 16 39 D (23) 16 39 0 10 10 16 16 21 23 39 39 49 A (10) B (6) E (5) G (16) I (10) 0 10 10 16 18 23 23 39 39 49 1@50 1@60 10 23 23 28 28 39 C (13) F (5) H (11) 10 3 23 28 28 39 1@200 1@300 04/11/2006 Emad Elbeltagi 23 Time-Cost Trade-Off Example Application Duratio Direct cost X 1000 LE Indirect cost x 1000 LE Total cost x 1000 LE n 59 36.50 7.375 43.875 57 36.62 7.125 43.745 55 36.77 6.875 43.645 53 36.97 6.625 43.595 51 37.17 6.375 43.545 49 37.87 6.125 43.995 04/11/2006 Emad Elbeltagi 24 12
  • 13.
    Time-Cost Trade-Off Example Application 50 40 LE x 1000 30 20 10 0 48 50 52 54 56 58 60 Time (days) 04/11/2006 Emad Elbeltagi 25 13
