SPM-UNIT III
RISK MANAGEMENT
RESOURCE ALLOCATION
Prof. Kanchana Devi
Resource Allocation- Introduction

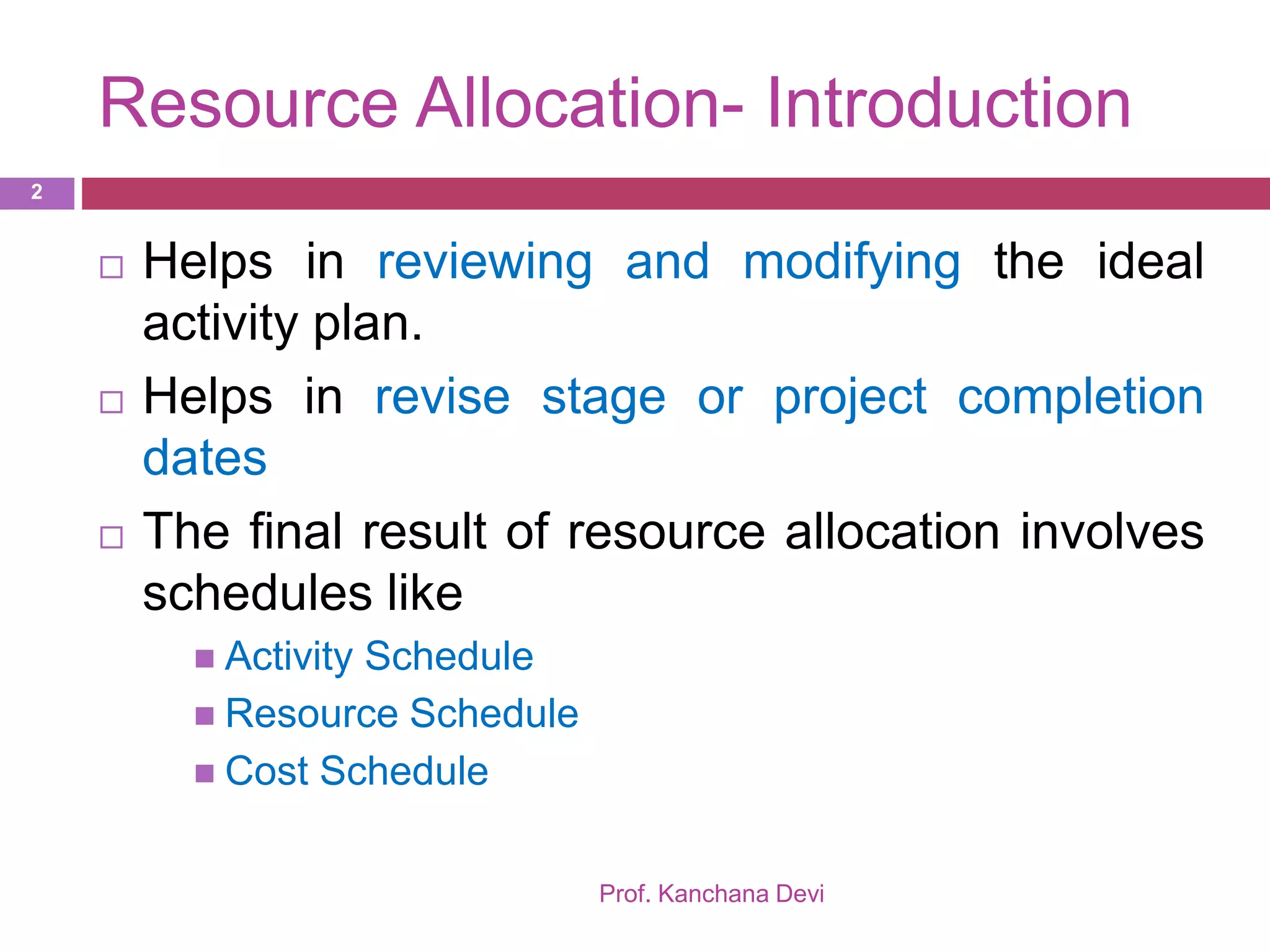

 Helps in reviewing and modifying the ideal
activity plan.
 Helps in revise stage or project completion
dates
 The final result of resource allocation involves
schedules like
 Activity Schedule
 Resource Schedule
 Cost Schedule
2
Prof. Kanchana Devi

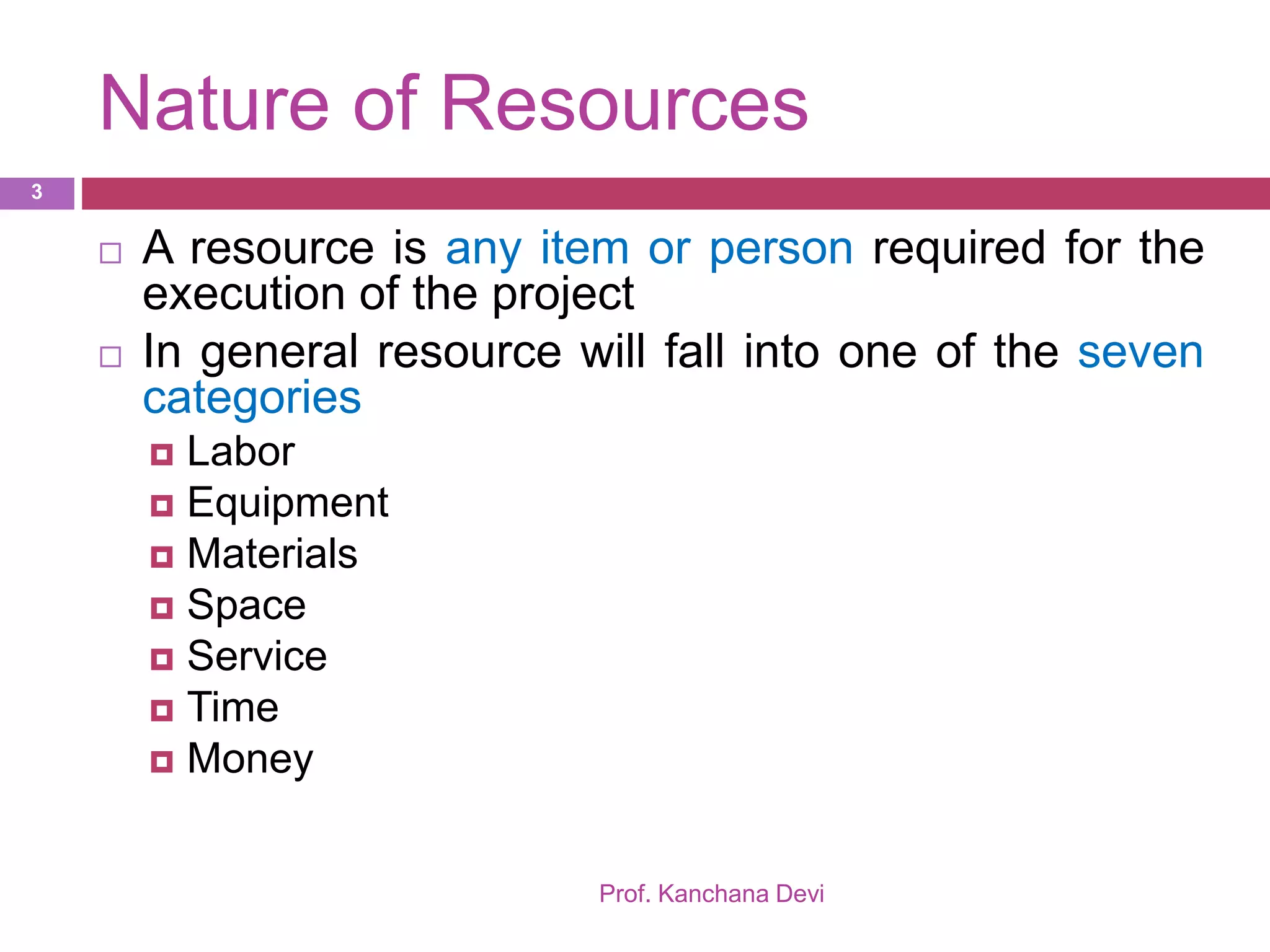

Nature of Resources
Prof. Kanchana Devi
3
 A resource is any item or person required for the
execution of the project
 In general resource will fall into one of the seven
categories
 Labor
 Equipment
 Materials
 Space
 Service
 Time
 Money
Identifying Resource Requirements
Prof. Kanchana Devi
4

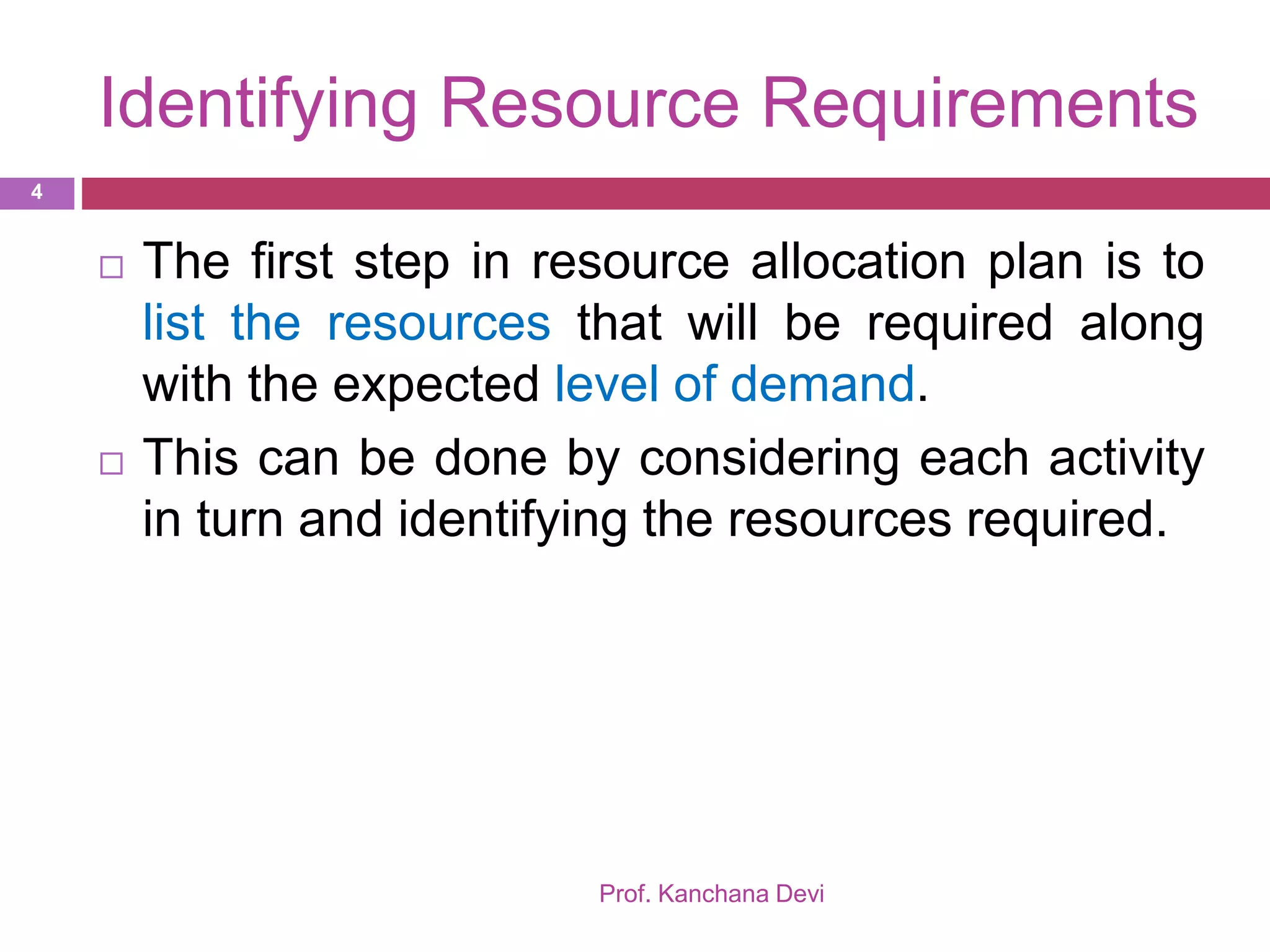

 The first step in resource allocation plan is to
list the resources that will be required along
with the expected level of demand.
 This can be done by considering each activity
in turn and identifying the resources required.
Identifying Resource Requirement
Prof. Kanchana Devi
5

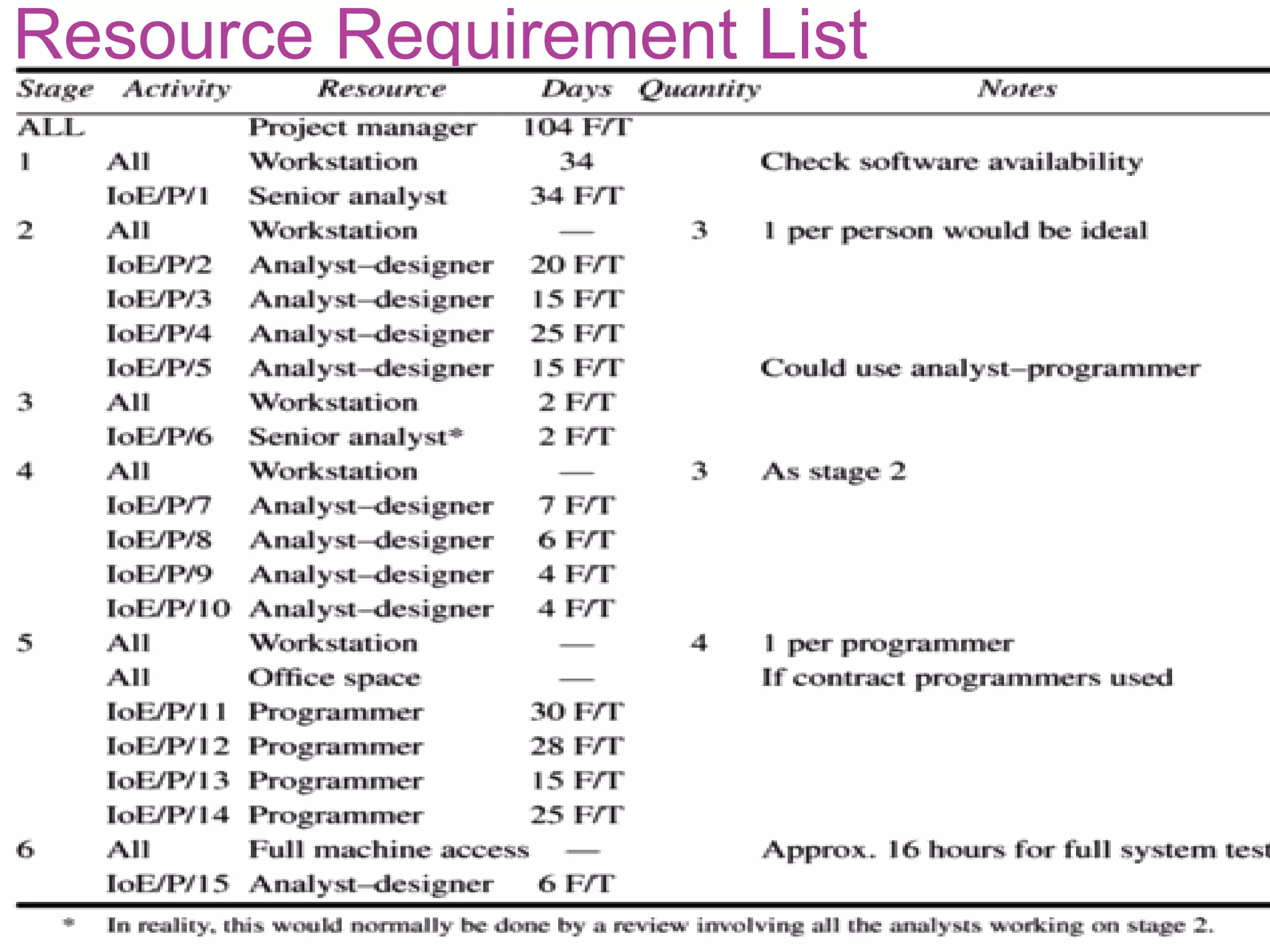

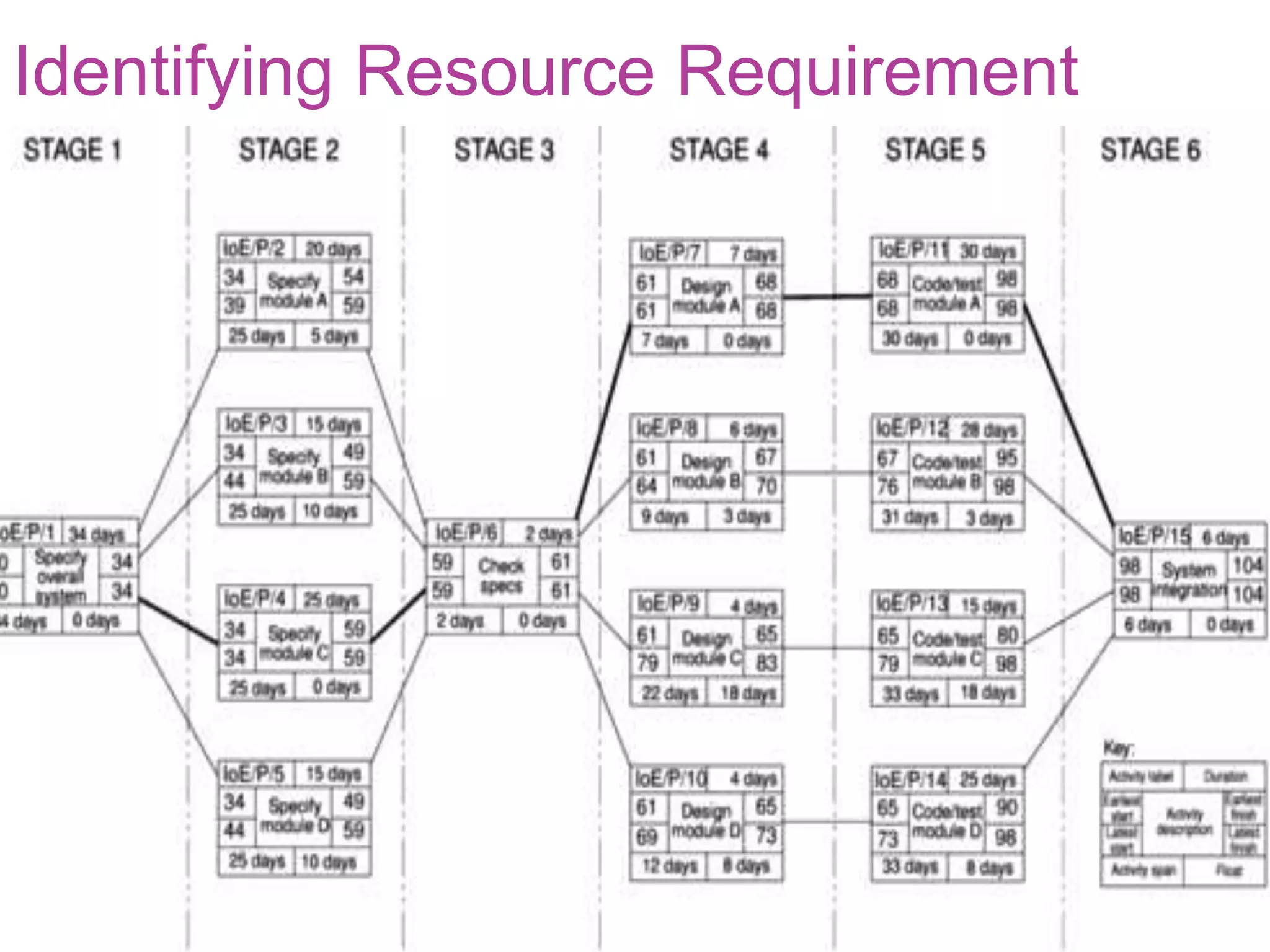

Resource Requirement List
Prof. Kanchana Devi
6

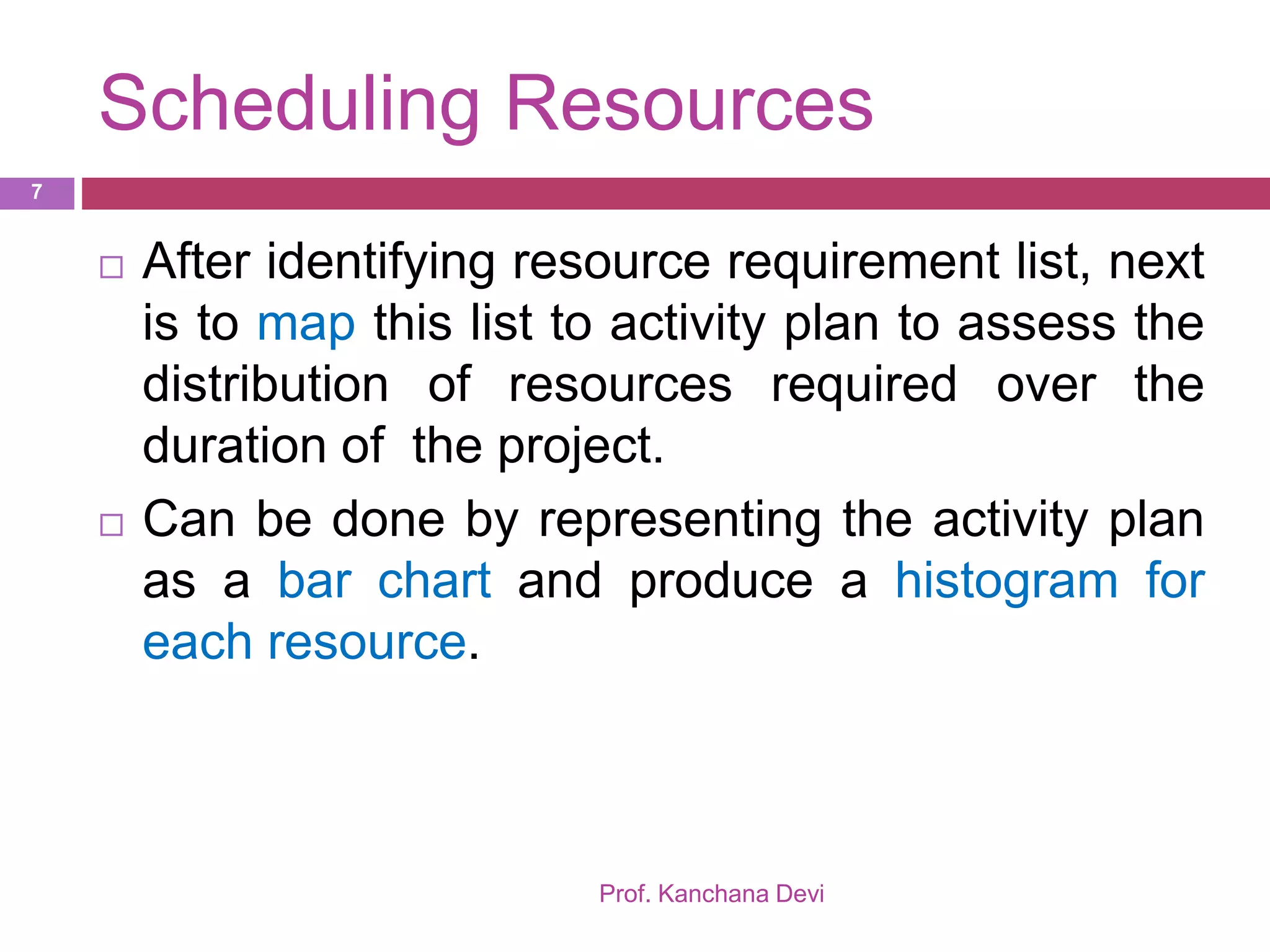

Scheduling Resources
Prof. Kanchana Devi
7
 After identifying resource requirement list, next
is to map this list to activity plan to assess the
distribution of resources required over the
duration of the project.
 Can be done by representing the activity plan
as a bar chart and produce a histogram for
each resource.
Prof. Kanchana Devi
8

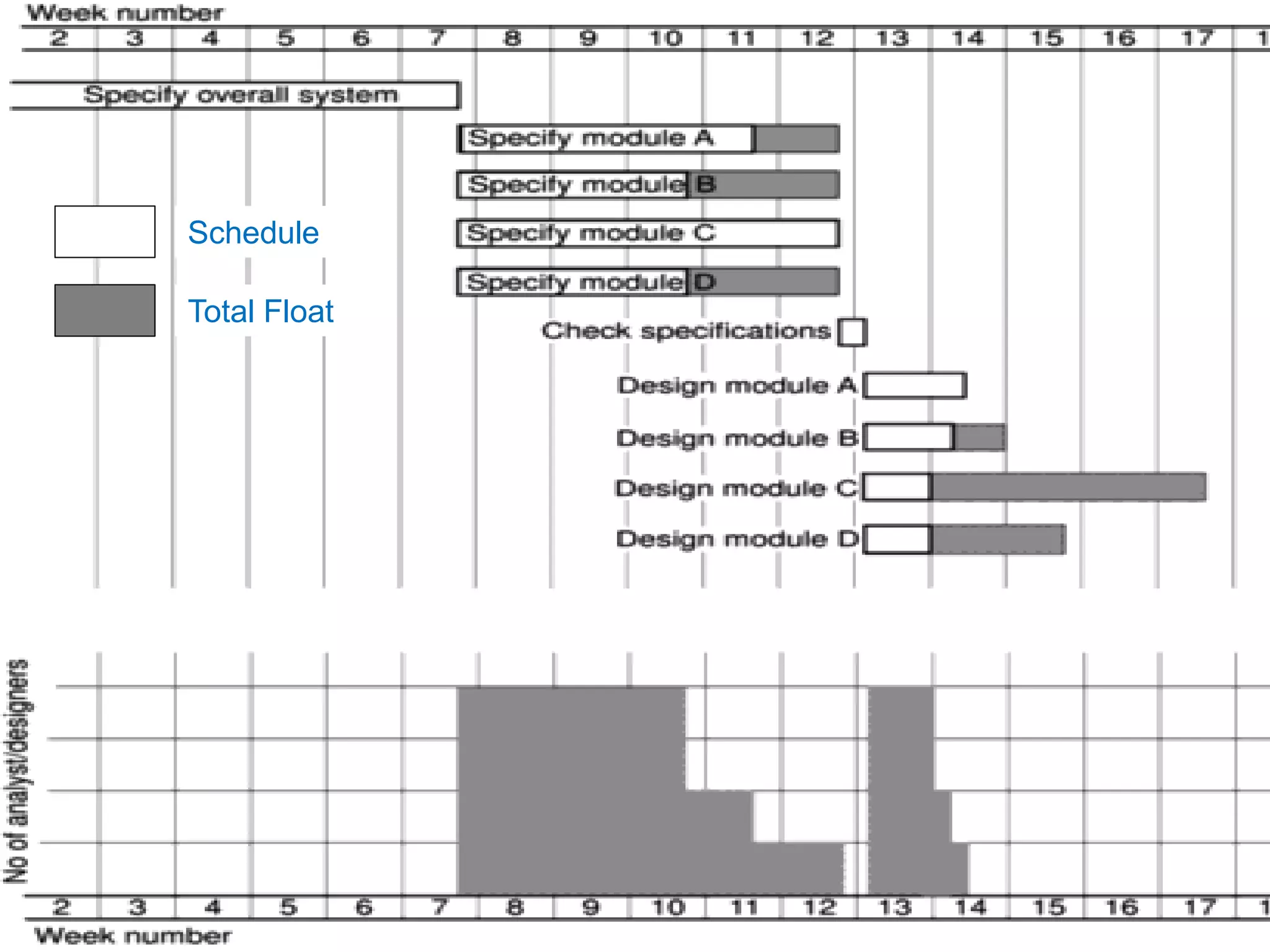

Schedule
Total Float
Problem
Prof. Kanchana Devi
9
 It causes two analyst/designers to be idle for
twelve days
 One for seven days
 One for two days between specification and
design
 Another problem in uneven histogram is it is
that more likely to call for levels of resource
beyond those available.
Prof. Kanchana Devi
10

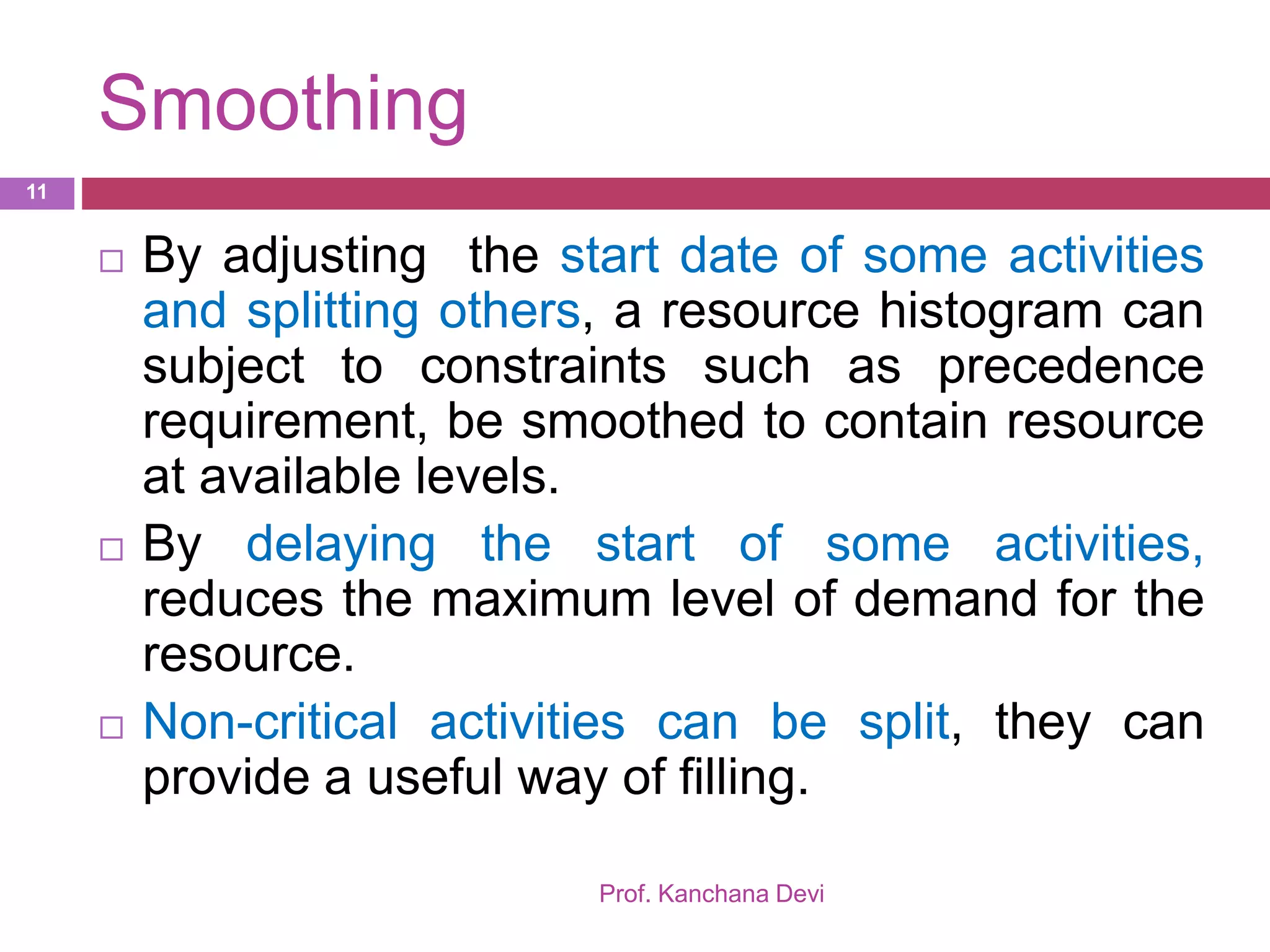

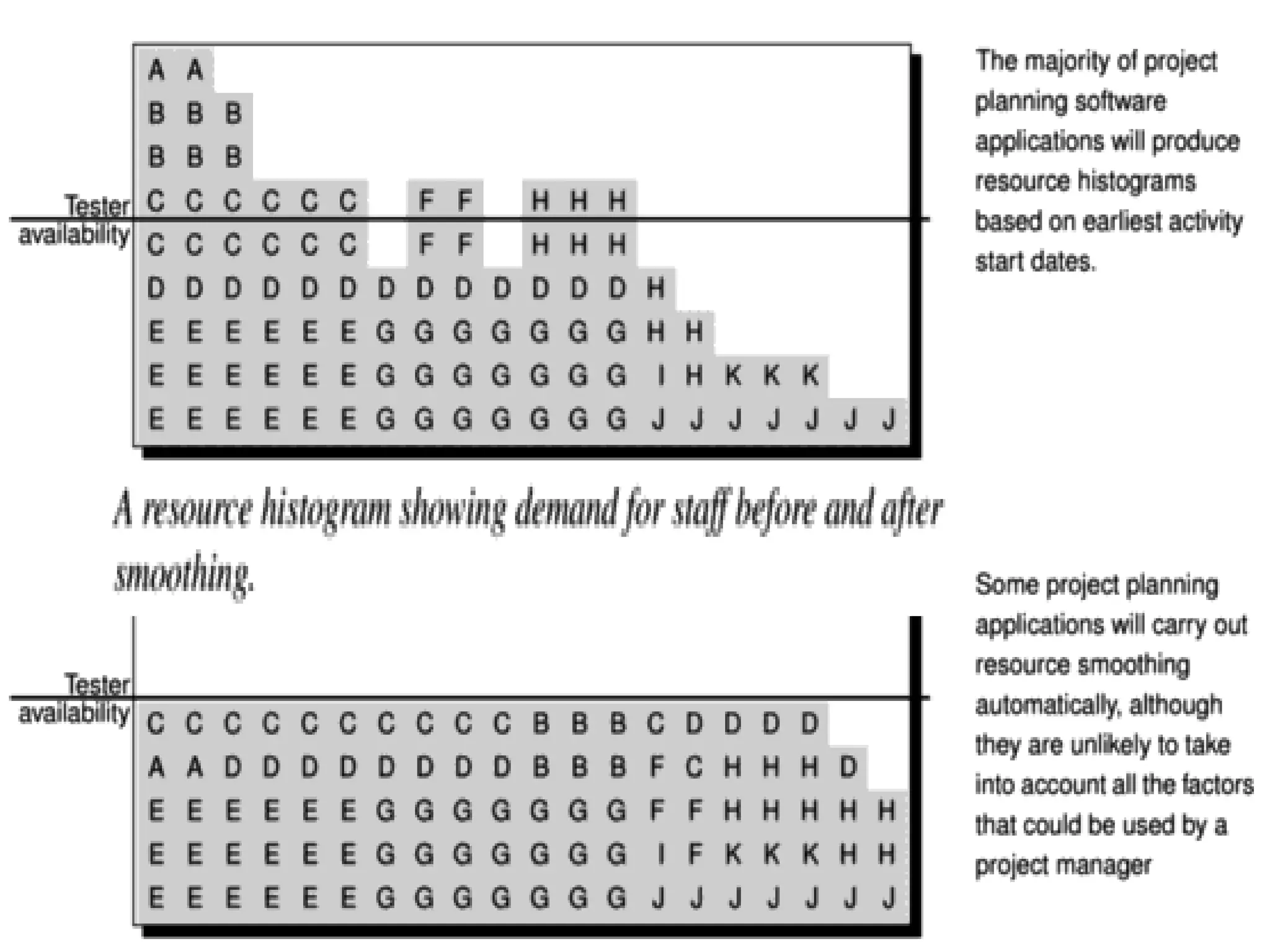

Smoothing
Prof. Kanchana Devi
11
 By adjusting the start date of some activities
and splitting others, a resource histogram can
subject to constraints such as precedence
requirement, be smoothed to contain resource
at available levels.
 By delaying the start of some activities,
reduces the maximum level of demand for the
resource.
 Non-critical activities can be split, they can
provide a useful way of filling.

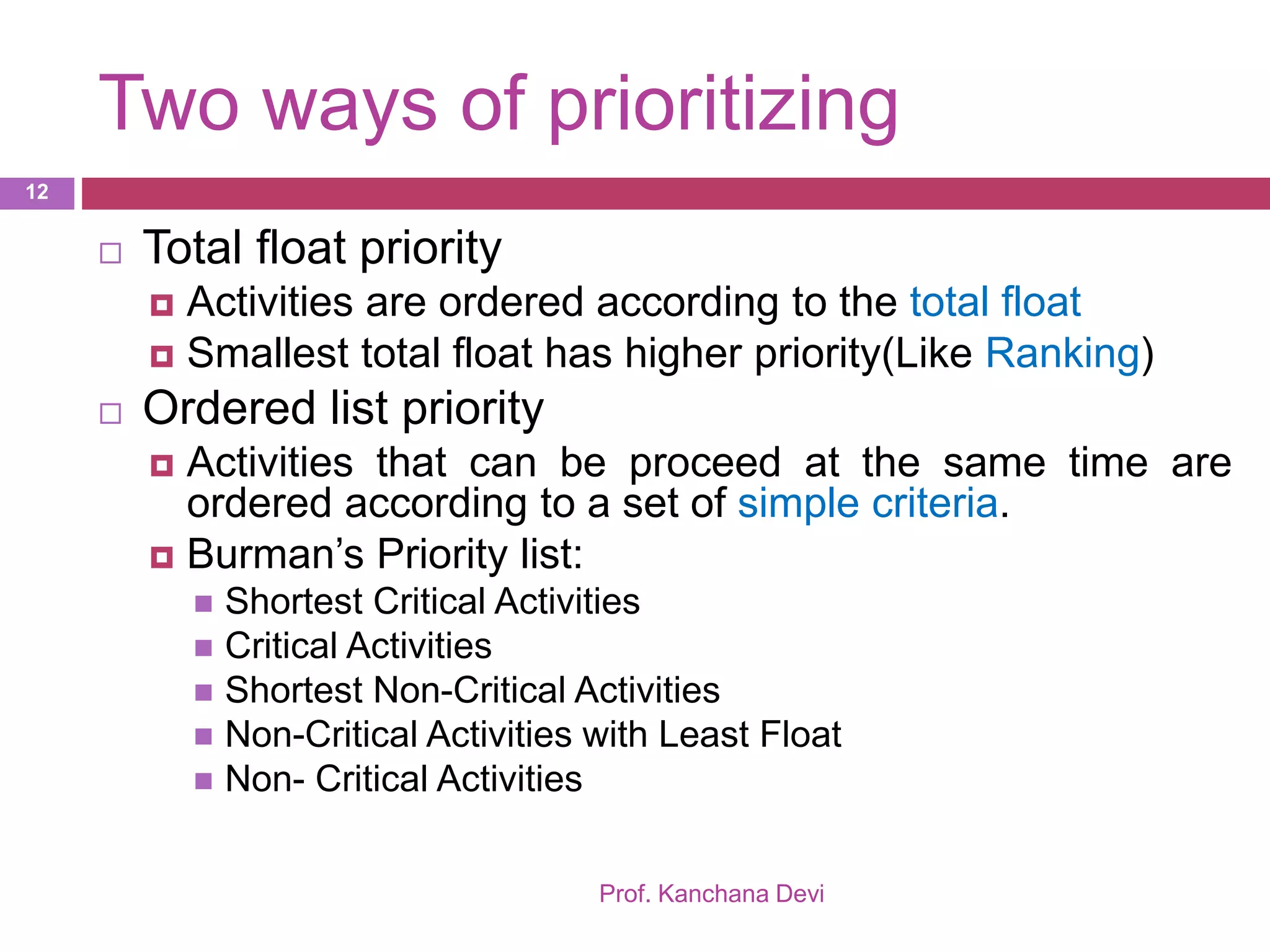

Two ways of prioritizing
Prof. Kanchana Devi
12
 Total float priority
 Activities are ordered according to the total float
 Smallest total float has higher priority(Like Ranking)
 Ordered list priority
 Activities that can be proceed at the same time are
ordered according to a set of simple criteria.
 Burman’s Priority list:
 Shortest Critical Activities
 Critical Activities
 Shortest Non-Critical Activities
 Non-Critical Activities with Least Float
 Non- Critical Activities

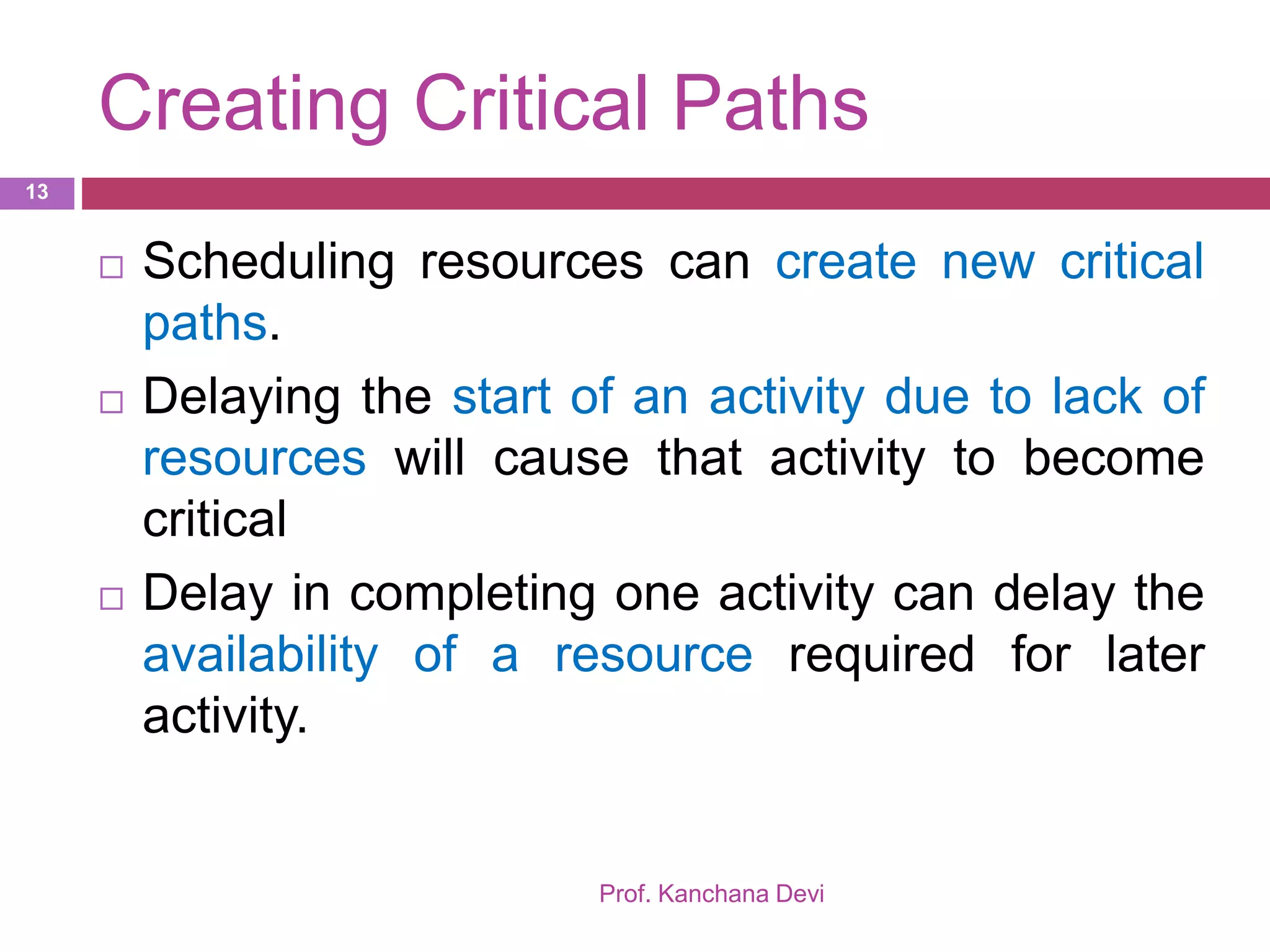

Creating Critical Paths
Prof. Kanchana Devi
13
 Scheduling resources can create new critical
paths.
 Delaying the start of an activity due to lack of
resources will cause that activity to become
critical
 Delay in completing one activity can delay the
availability of a resource required for later
activity.
Allocating Individuals
Prof. Kanchana Devi
14
 Availability
 Criticality
 Risk
 Training
 Team Building
Cost Schedule
Prof. Kanchana Devi
15

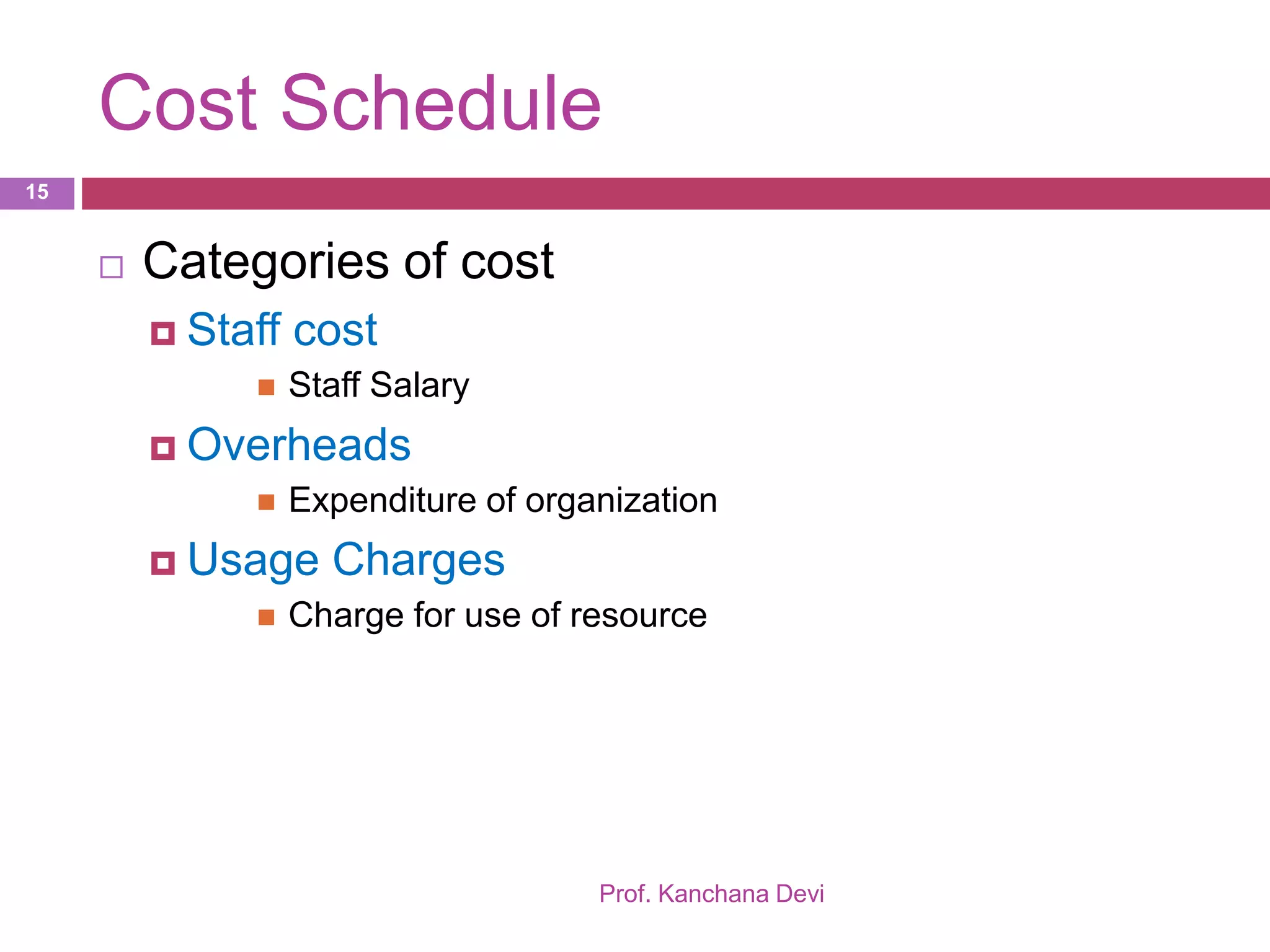

 Categories of cost
 Staff cost
 Staff Salary
 Overheads
 Expenditure of organization
 Usage Charges
 Charge for use of resource
