SlideShare a Scribd company logo
Six Sigma With R
  (Springer, 2012)

      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e
                                             Six Sigma with R
Frontmatter
                                   Statistical Engineering for Process
Mainmatter                                     Improvement
I Basics
II Define
III Measure
IV Analyze
V Improve
VI Control
                                 Emilio L. Cano, Javier M. Moguerza
VII Further and Beyond

Backmatter
                                         and Andr´s Redchuk
                                                  e

                                                 November 20, 2012

                                        Facultad de Estudios Estad´
                                                                  ısticos
                                       Universidad Complutense de Madrid

                         Book Presentation UCM                              1/59
Six Sigma With R
  (Springer, 2012)       Contenido
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e                 1   Frontmatter
Frontmatter

Mainmatter
                         2   Mainmatter
I Basics
II Define                      I Basics
III Measure
IV Analyze
V Improve
                              II Define
VI Control
VII Further and Beyond
                              III Measure
Backmatter                    IV Analyze
                              V Improve
                              VI Control
                              VII Further and Beyond
                         3   Backmatter

                         Book Presentation UCM         2/59
Six Sigma With R
  (Springer, 2012)       Contents
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e                 1   Frontmatter
Frontmatter

Mainmatter
                         2   Mainmatter
I Basics
II Define                      I Basics
III Measure
IV Analyze
V Improve
                              II Define
VI Control
VII Further and Beyond
                              III Measure
Backmatter                    IV Analyze
                              V Improve
                              VI Control
                              VII Further and Beyond
                         3   Backmatter

                         Book Presentation UCM         3/59
Six Sigma With R

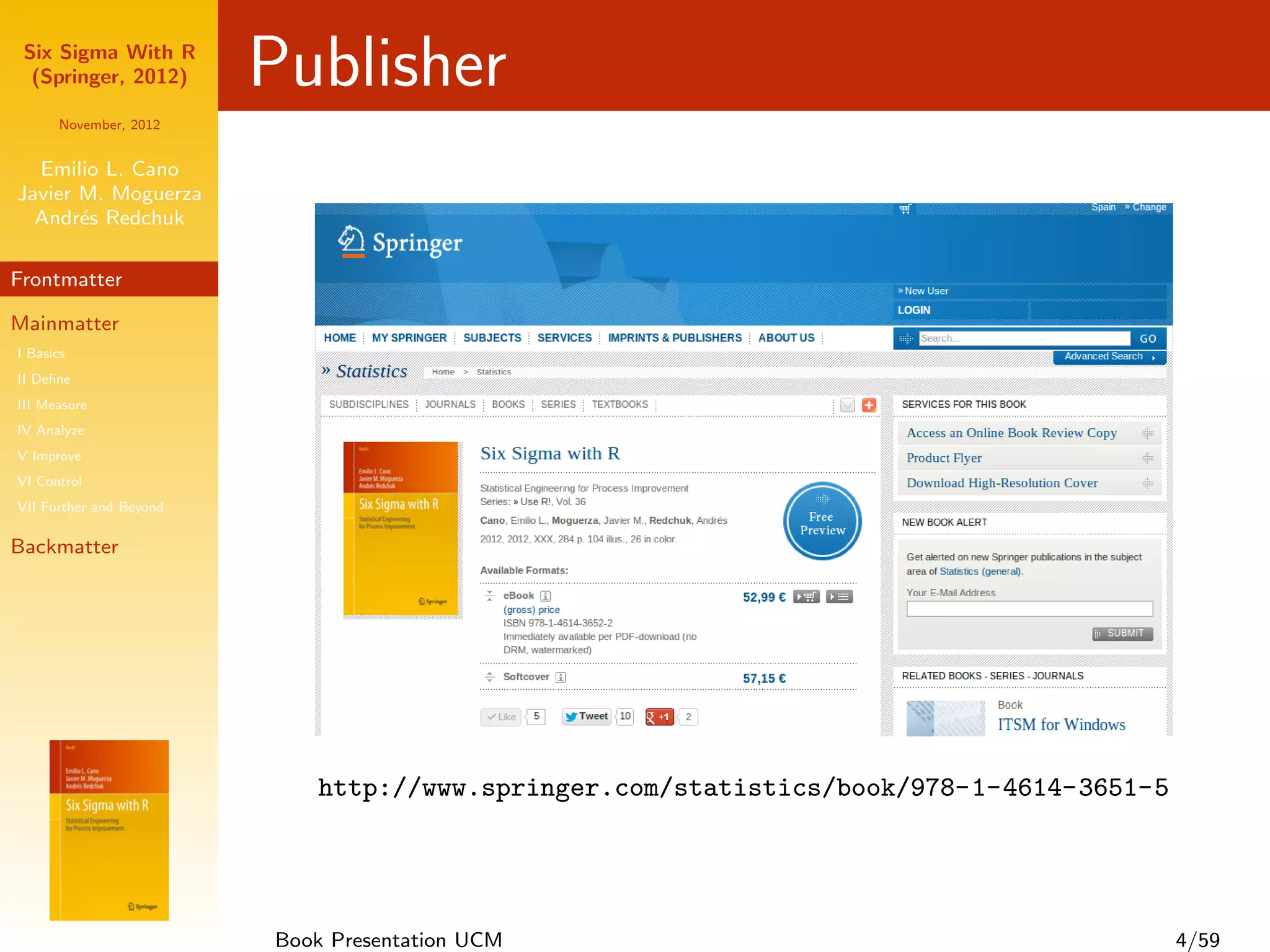

  (Springer, 2012)       Publisher
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter

Mainmatter
I Basics
II Define
III Measure
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter

                            http://www.springer.com/statistics/book/978-1-4614-3651-5

                         Book Presentation UCM                                          4/59
Six Sigma With R
  (Springer, 2012)       Book website
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter

Mainmatter
I Basics
II Define
III Measure
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter

                                 http://www.sixsigmawithr.com/

                         Book Presentation UCM                   5/59
Six Sigma With R
  (Springer, 2012)       R Package
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter

Mainmatter
I Basics
II Define
III Measure
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter

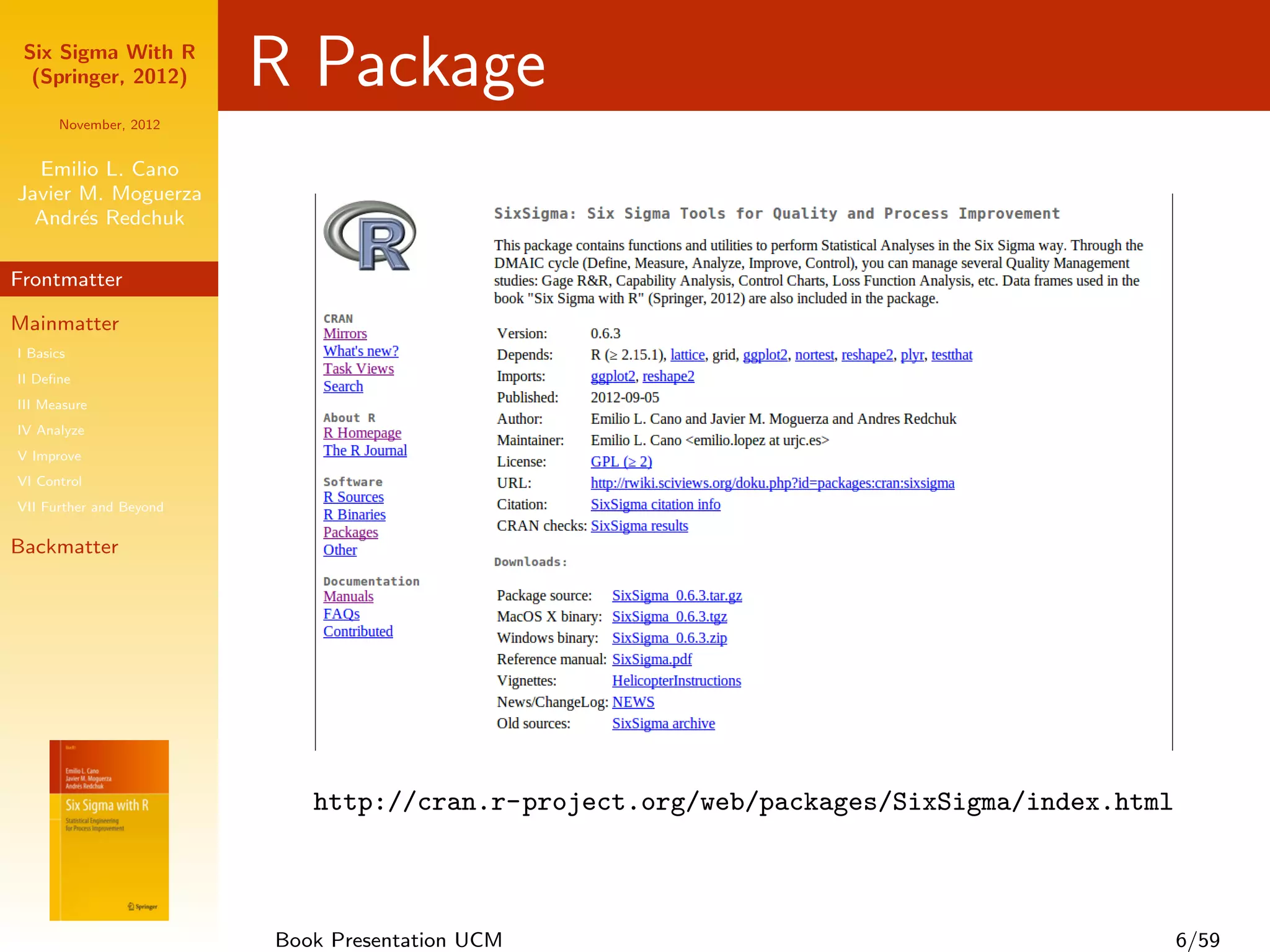

                            http://cran.r-project.org/web/packages/SixSigma/index.html

                         Book Presentation UCM                                           6/59

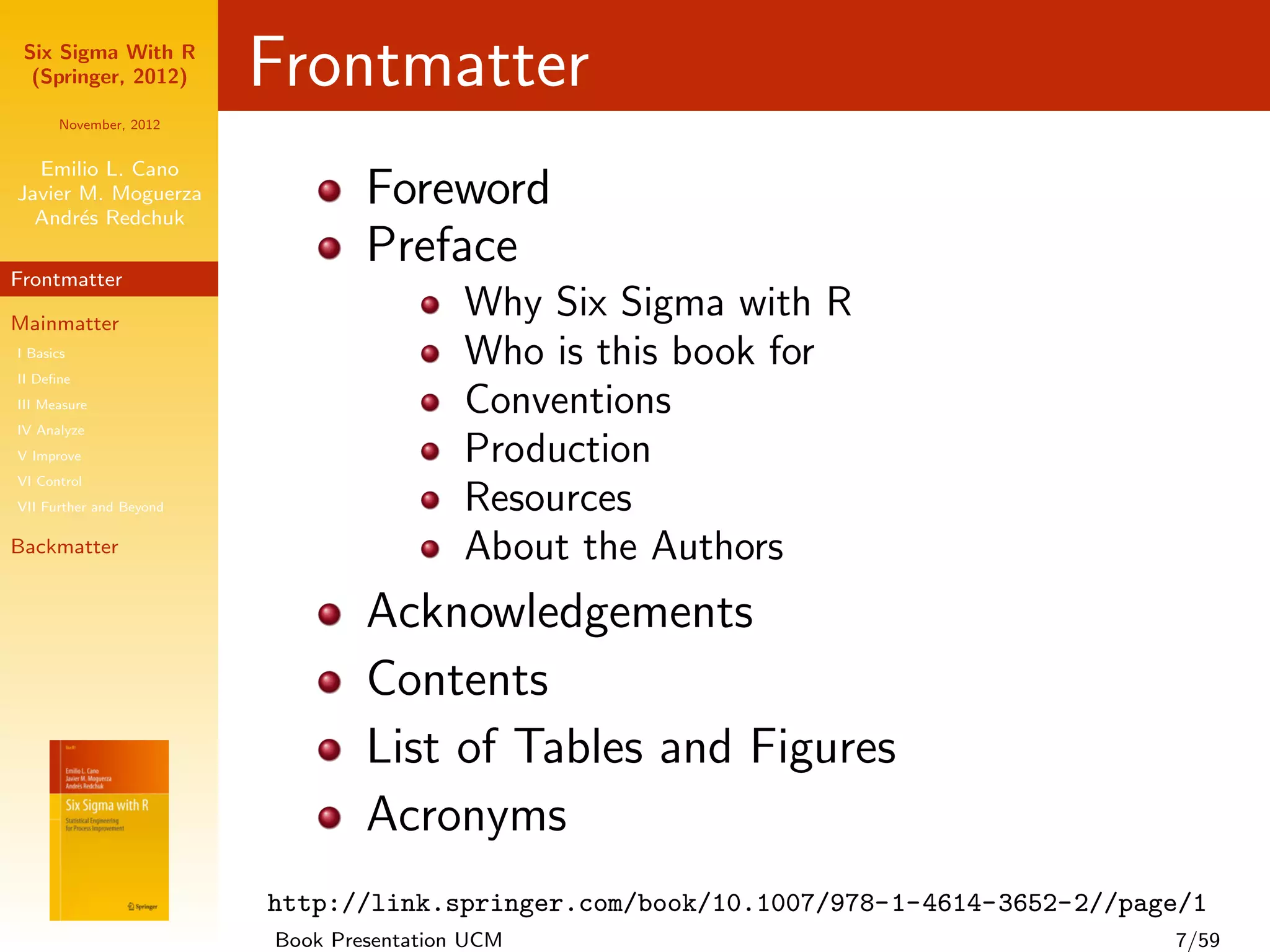

Six Sigma With R
  (Springer, 2012)       Frontmatter
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e
                                 Foreword
Frontmatter
                                 Preface
Mainmatter
                                          Why Six Sigma with R
I Basics
II Define
                                          Who is this book for
III Measure                               Conventions
IV Analyze
V Improve                                 Production
VI Control
VII Further and Beyond                    Resources
Backmatter                                About the Authors
                                 Acknowledgements
                                 Contents
                                 List of Tables and Figures
                                 Acronyms
                         http://link.springer.com/book/10.1007/978-1-4614-3652-2//page/1
                         Book Presentation UCM                                       7/59
Six Sigma With R
  (Springer, 2012)       Contents
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e                 1   Frontmatter
Frontmatter

Mainmatter
                         2   Mainmatter
I Basics
II Define                      I Basics
III Measure
IV Analyze
V Improve
                              II Define
VI Control
VII Further and Beyond
                              III Measure
Backmatter                    IV Analyze
                              V Improve
                              VI Control
                              VII Further and Beyond
                         3   Backmatter

                         Book Presentation UCM         8/59
Six Sigma With R
  (Springer, 2012)       1. Six Sigma in a Nutshell
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter              Herbert Spencer
Mainmatter
I Basics                            “Science is organised knowledge”
II Define
III Measure
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter

                         Book Presentation UCM                         9/59
Six Sigma With R

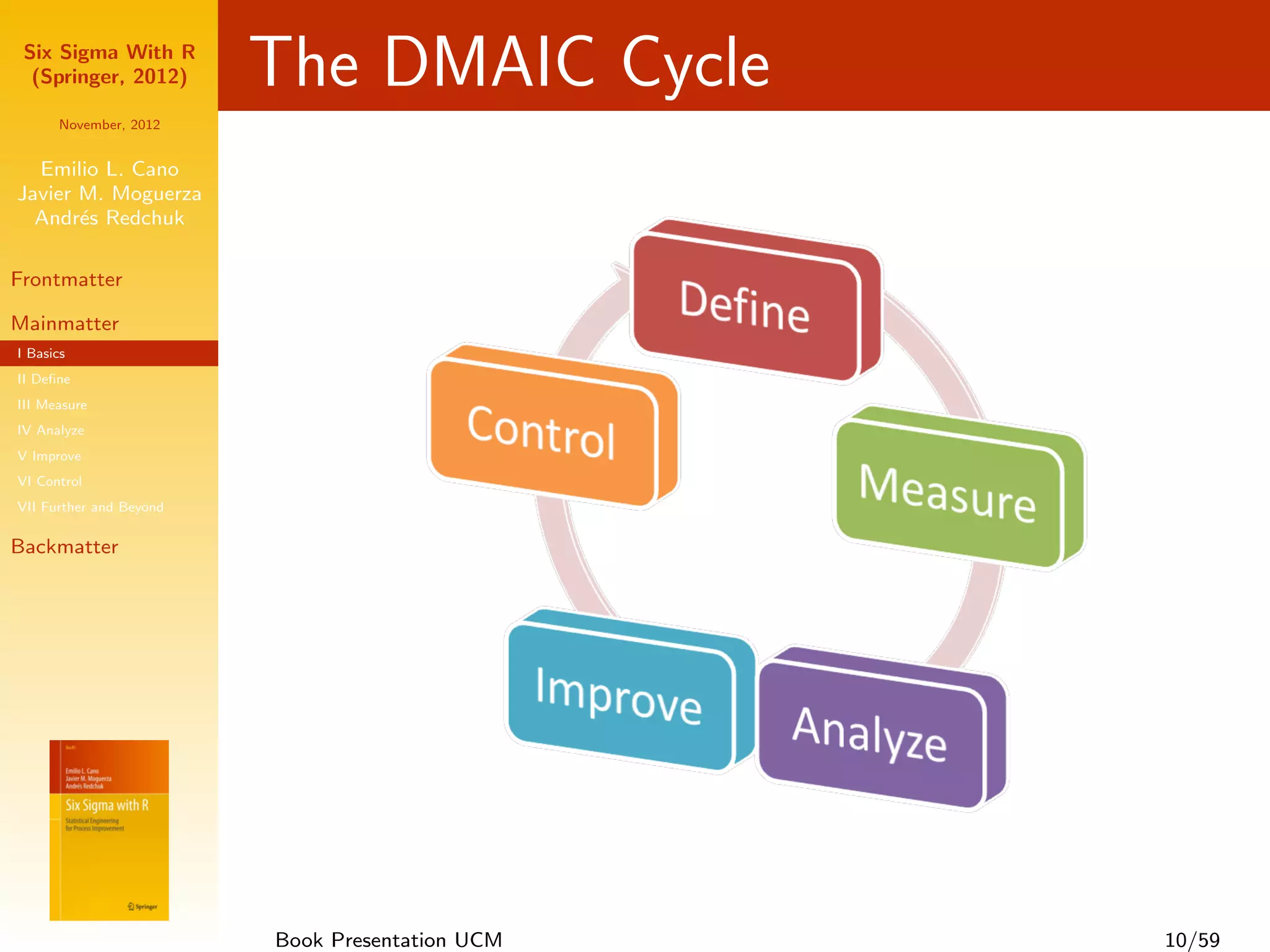

  (Springer, 2012)       The DMAIC Cycle
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter

Mainmatter
I Basics
II Define
III Measure
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter

                         Book Presentation UCM   10/59
Six Sigma With R
  (Springer, 2012)       Six Sigma Roles
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

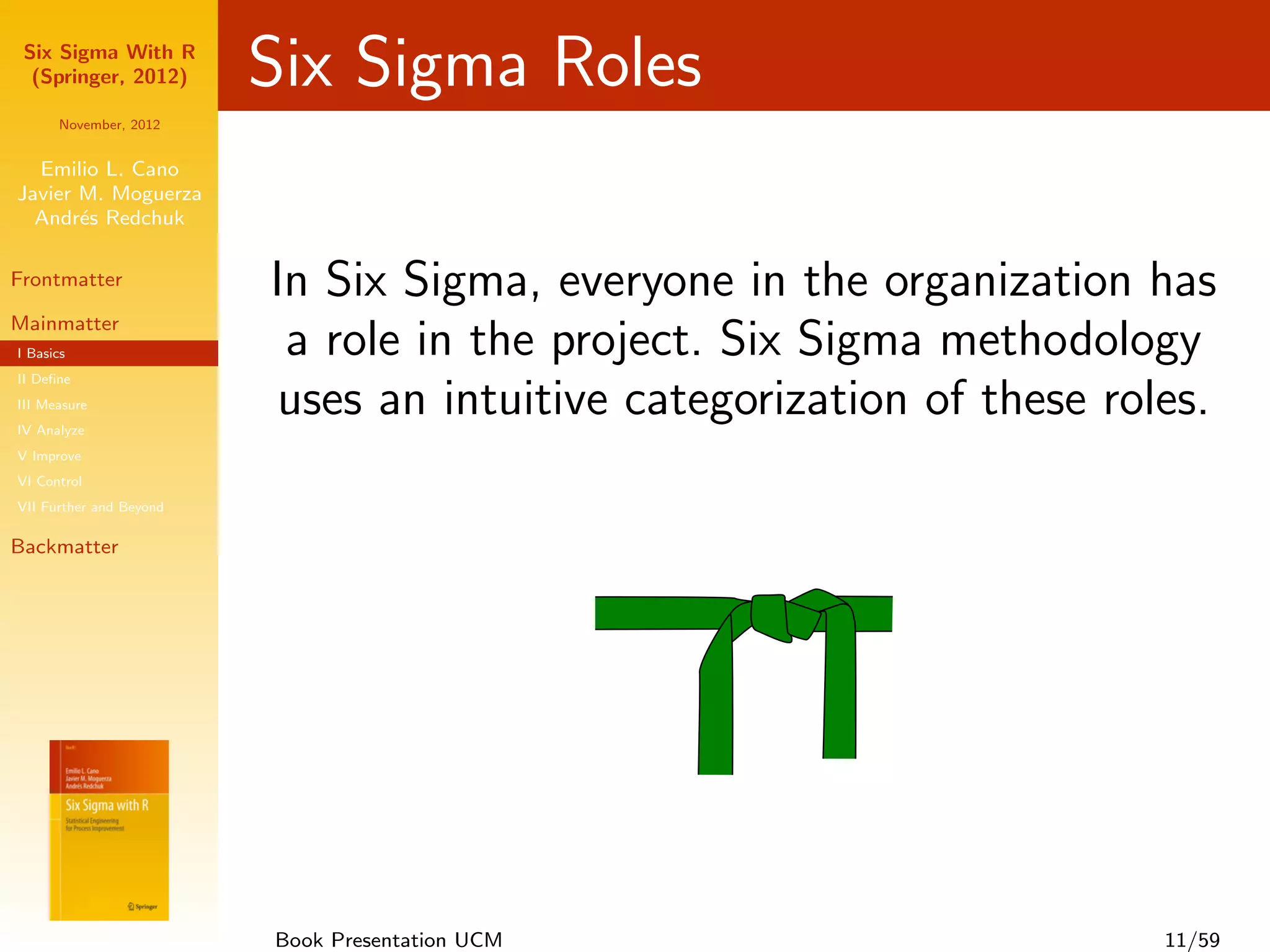

Frontmatter              In Six Sigma, everyone in the organization has
Mainmatter
I Basics                  a role in the project. Six Sigma methodology
II Define
III Measure
IV Analyze
                          uses an intuitive categorization of these roles.
V Improve
VI Control
VII Further and Beyond

Backmatter

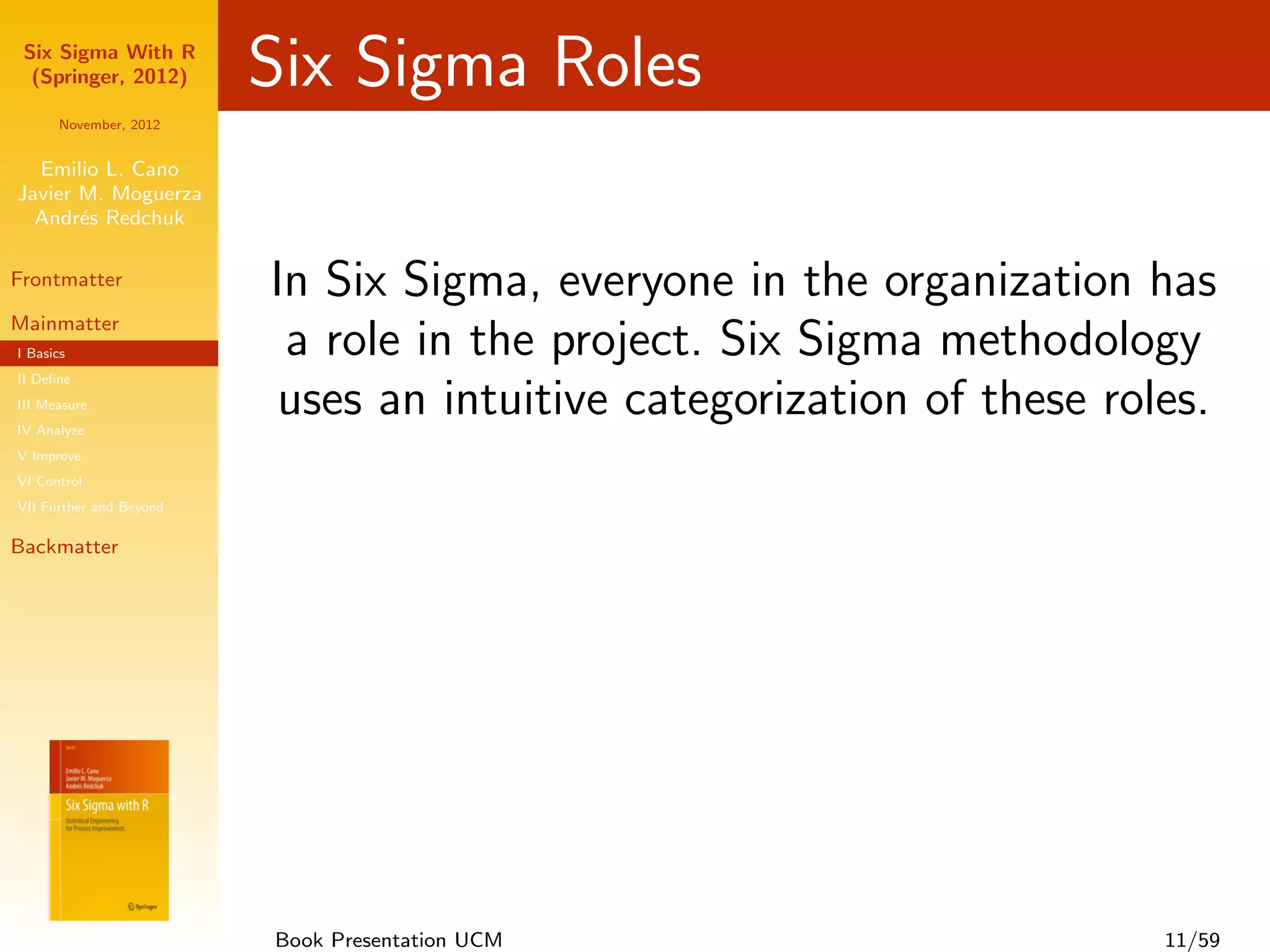

                         Book Presentation UCM                         11/59
Six Sigma With R
  (Springer, 2012)       Six Sigma Roles
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter              In Six Sigma, everyone in the organization has
Mainmatter
I Basics                  a role in the project. Six Sigma methodology
II Define
III Measure
IV Analyze
                          uses an intuitive categorization of these roles.
V Improve
VI Control
VII Further and Beyond

Backmatter

                         Book Presentation UCM                         11/59
Six Sigma With R
  (Springer, 2012)       2. R from the Beginning
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter              Linus Torvalds
Mainmatter
I Basics
                         “Software is like sex; it’s better when it’s free”
II Define
III Measure
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter

                         Book Presentation UCM                         12/59
Six Sigma With R

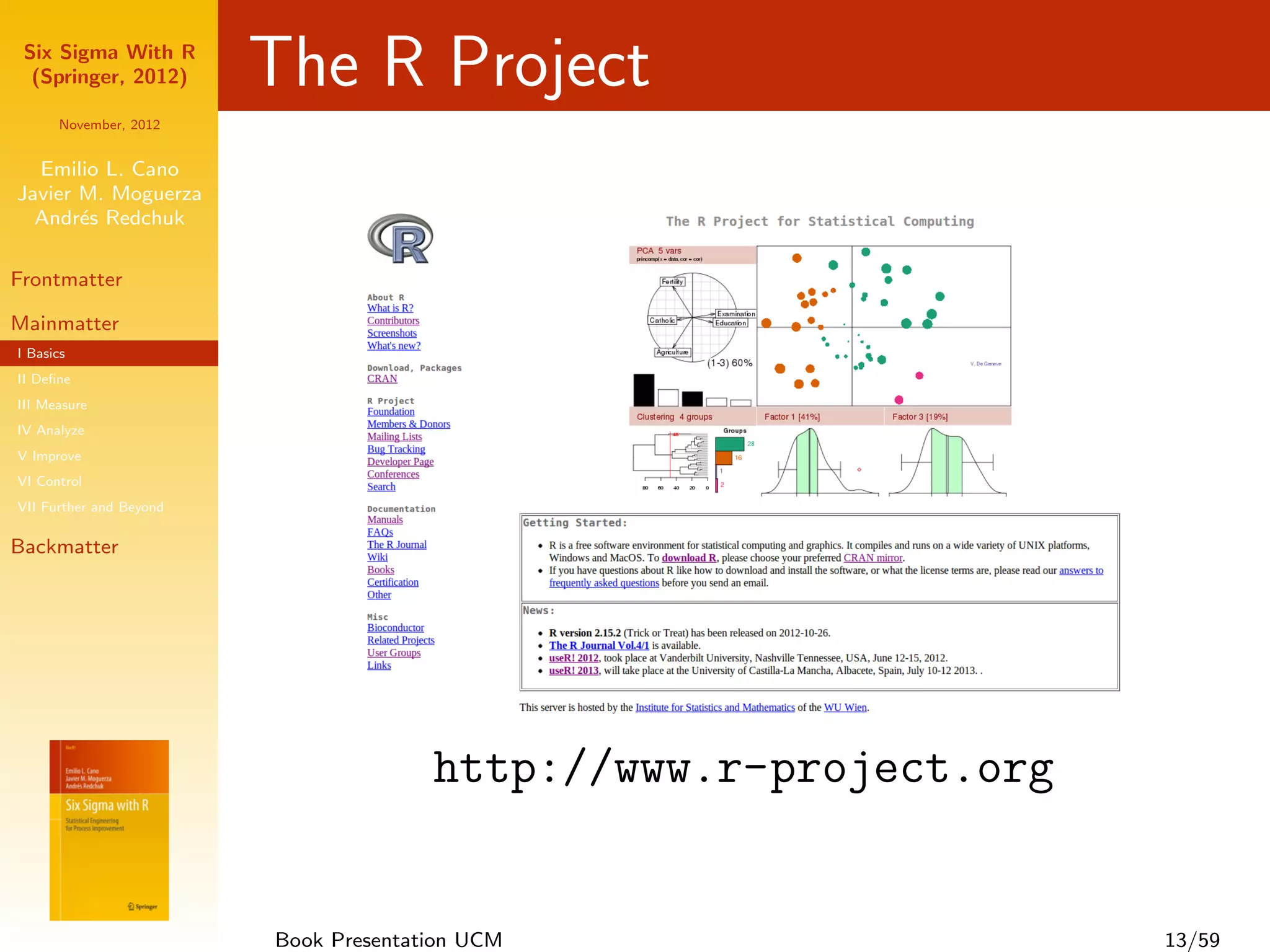

  (Springer, 2012)       The R Project
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter

Mainmatter
I Basics
II Define
III Measure
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter

                                       http://www.r-project.org

                         Book Presentation UCM                    13/59

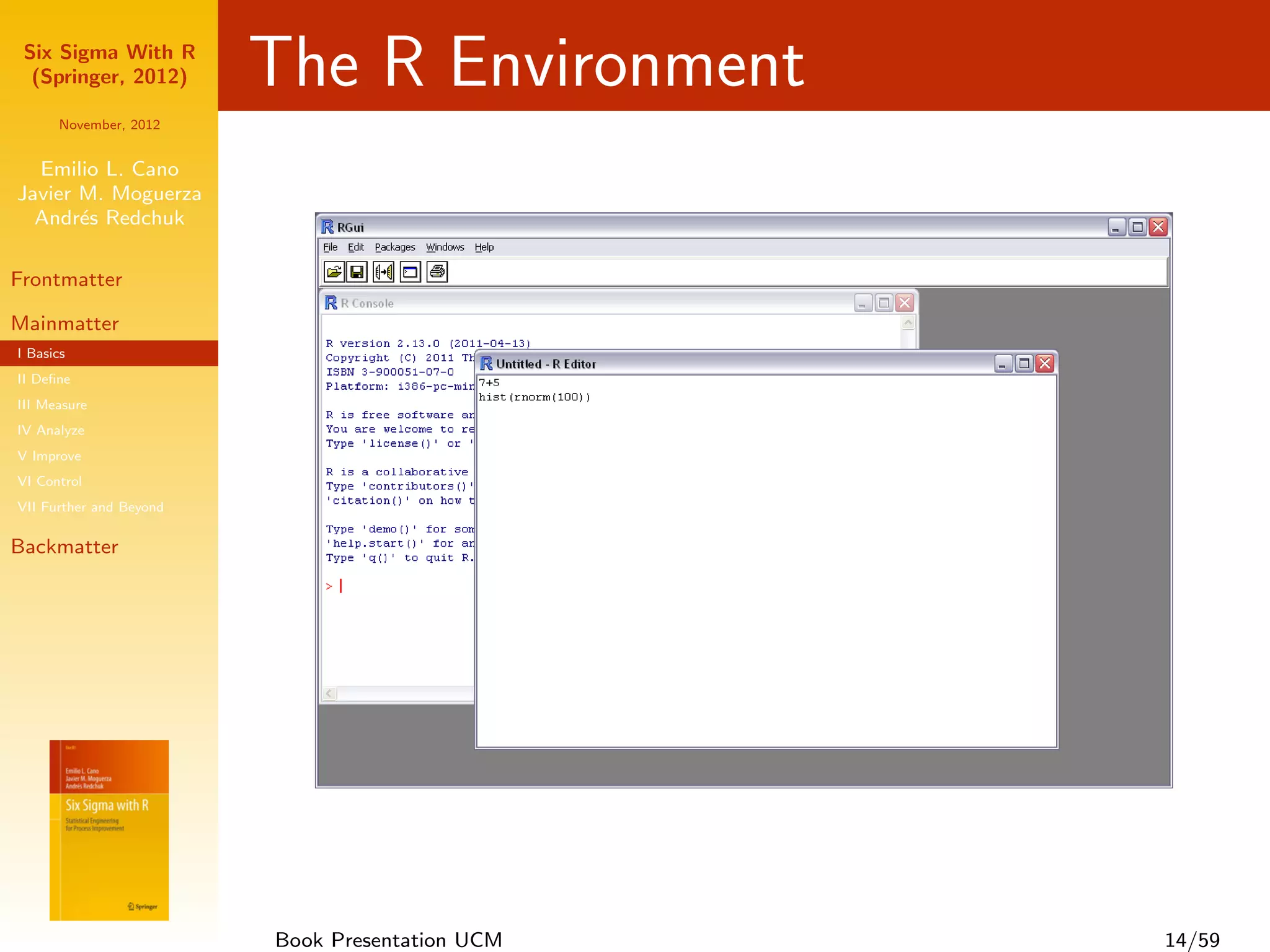

Six Sigma With R
  (Springer, 2012)       The R Environment
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter

Mainmatter
I Basics
II Define
III Measure
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter

                         Book Presentation UCM   14/59
Six Sigma With R
  (Springer, 2012)       3. Process Mapping with R
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter
                         Charles Franklin Kettering
Mainmatter
I Basics
                             “A problem well stated is a problem half
II Define
III Measure
                                             solved”
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter

                         Book Presentation UCM                          15/59

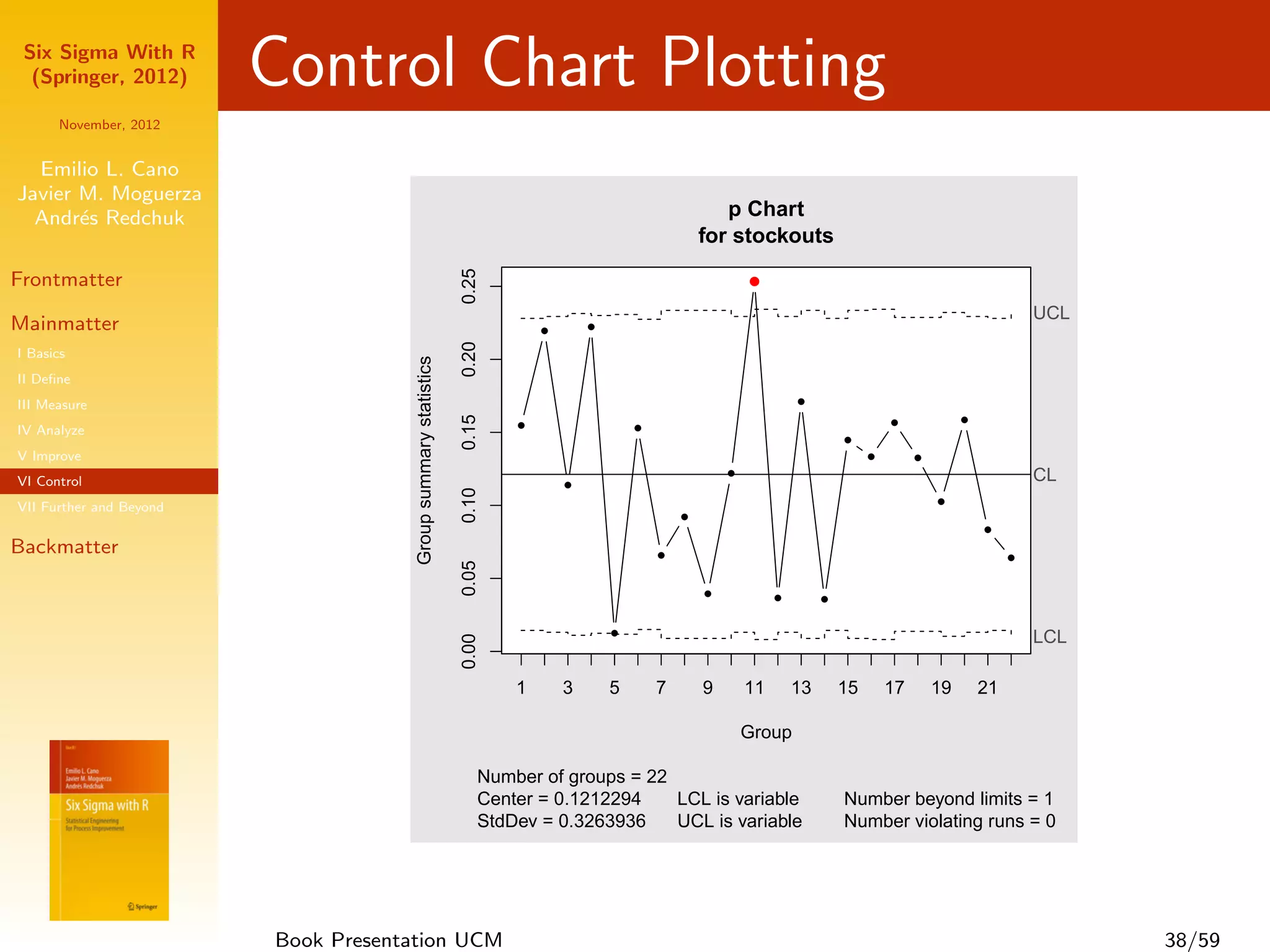

Six Sigma With R

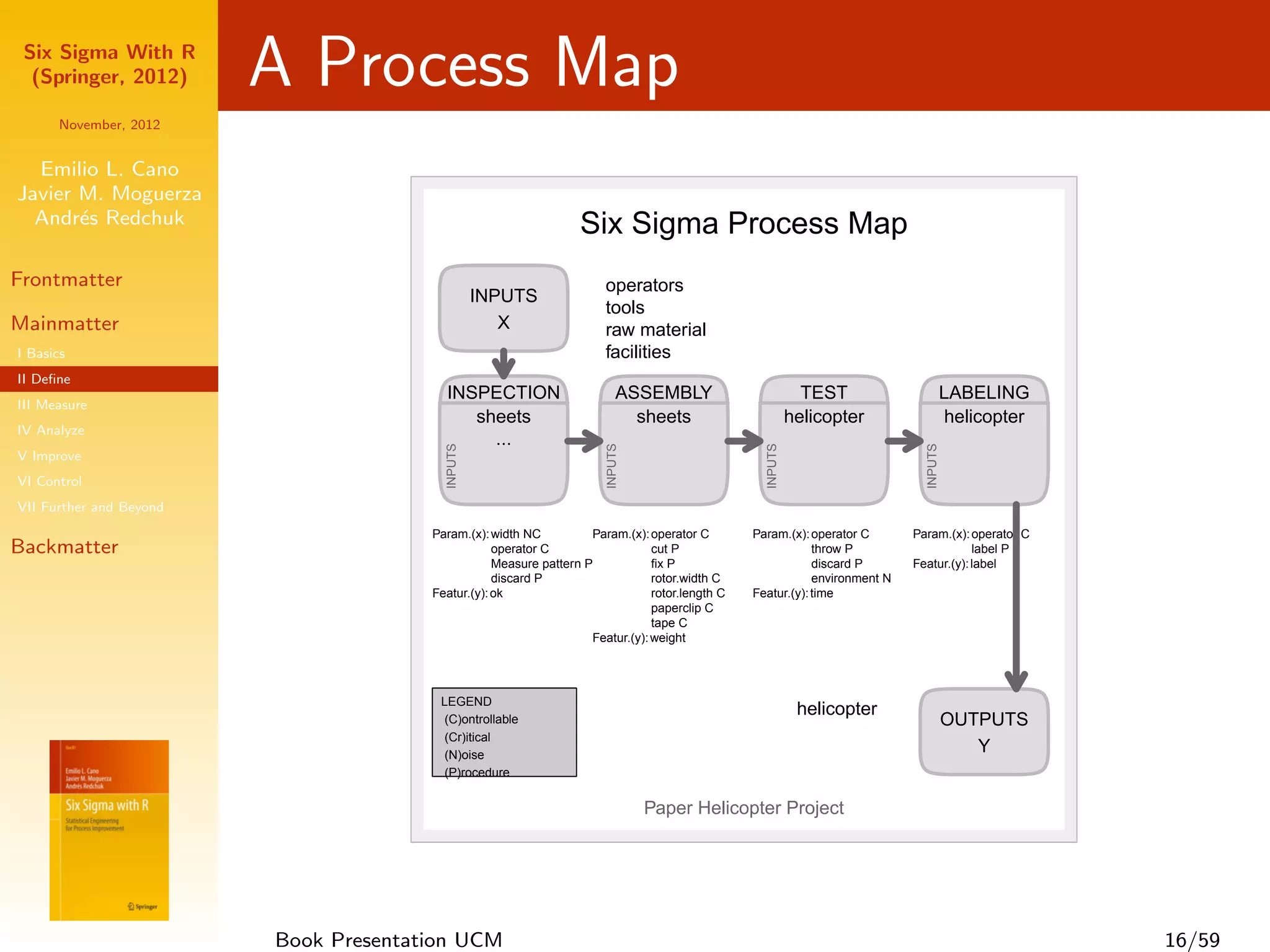

  (Springer, 2012)       A Process Map
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e                                             Six Sigma Process Map
Frontmatter                                               operators
                                     INPUTS
                                                          tools
Mainmatter                              X                 raw material
I Basics                                                  facilities
II Define
                            INSPECTION                        ASSEMBLY                           TEST                      LABELING
III Measure
                               sheets                           sheets                         helicopter                  helicopter
IV Analyze
                                 ...
                            INPUTS

                                                          INPUTS

                                                                                      INPUTS

                                                                                                                  INPUTS
V Improve
VI Control
VII Further and Beyond
                          Param.(x): width NC          Param.(x): operator C        Param.(x): operator C       Param.(x): operator C
Backmatter                            operator C                   cut P                        throw P                     label P
                                      Measure pattern P            fix P                        discard P       Featur.(y): label
                                      discard P                    rotor.width C                environment N
                          Featur.(y): ok                           rotor.length C   Featur.(y): time
                                                                   paperclip C
                                                                   tape C
                                                       Featur.(y): weight

                           LEGEND
                                                                                                helicopter
                           (C)ontrollable                                                                                  OUTPUTS
                           (Cr)itical
                           (N)oise
                                                                                                                              Y
                           (P)rocedure

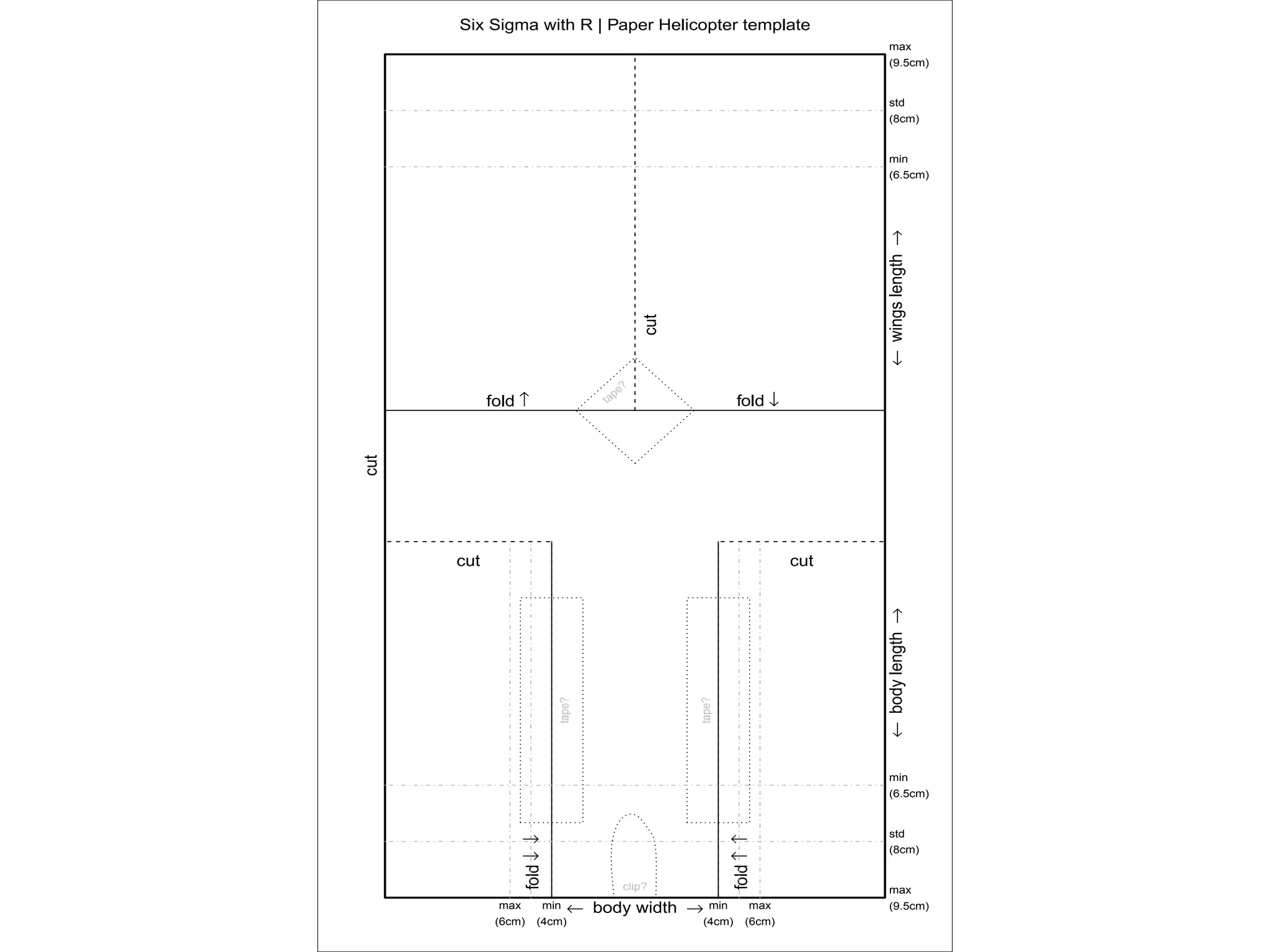

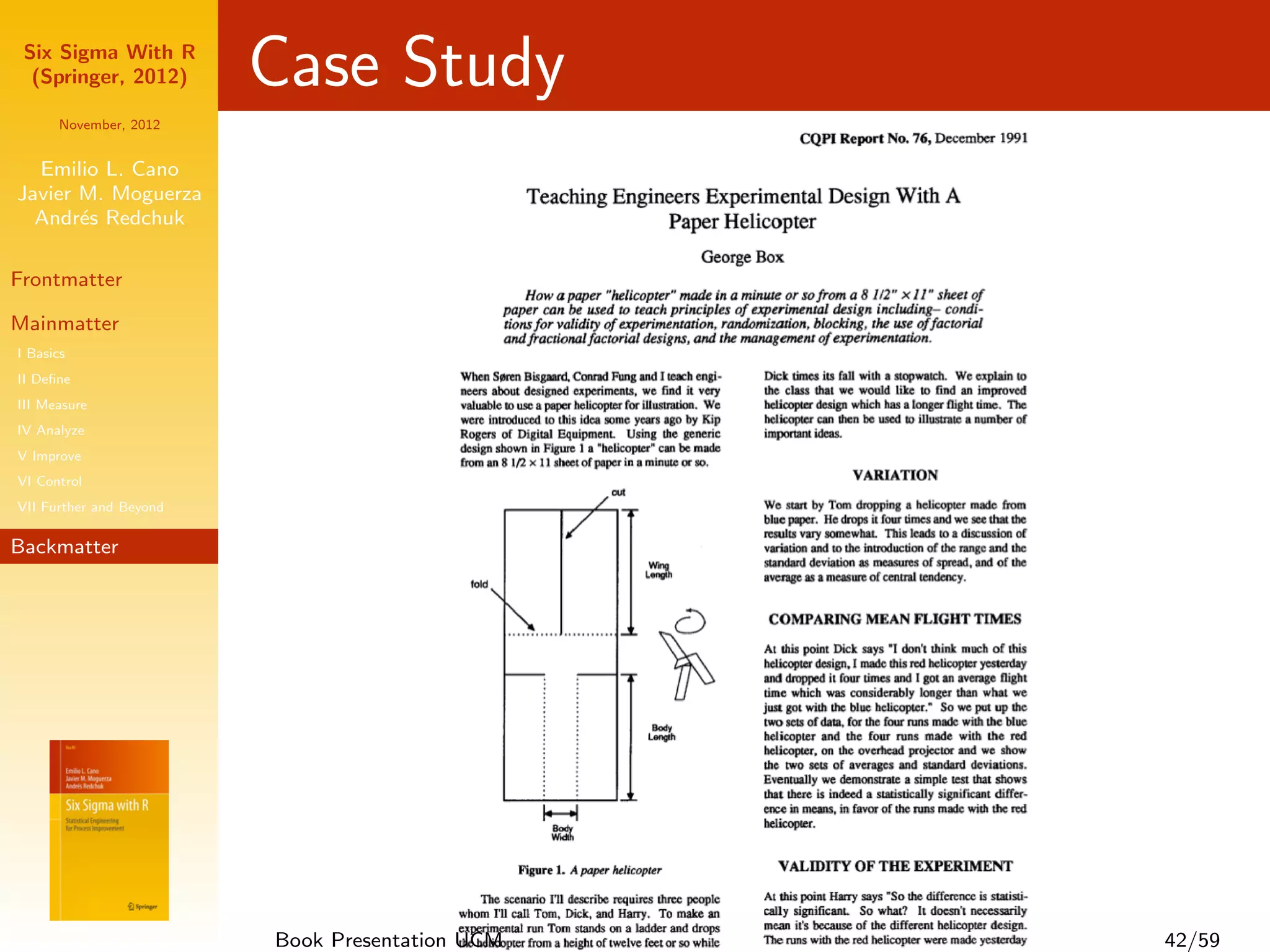

                                                                   Paper Helicopter Project

                         Book Presentation UCM                                                                                          16/59
Six Sigma With R
  (Springer, 2012)       4. Loss Funtion Analysis with R
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter              W. Edwards Deming
Mainmatter
I Basics
II Define
                          Defects are not free. Somebody makes them,
III Measure
IV Analyze
                                 and gets paid for making them
V Improve
VI Control
VII Further and Beyond

Backmatter

                         Book Presentation UCM                    17/59
Six Sigma With R
  (Springer, 2012)       A Loss Function Example
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk

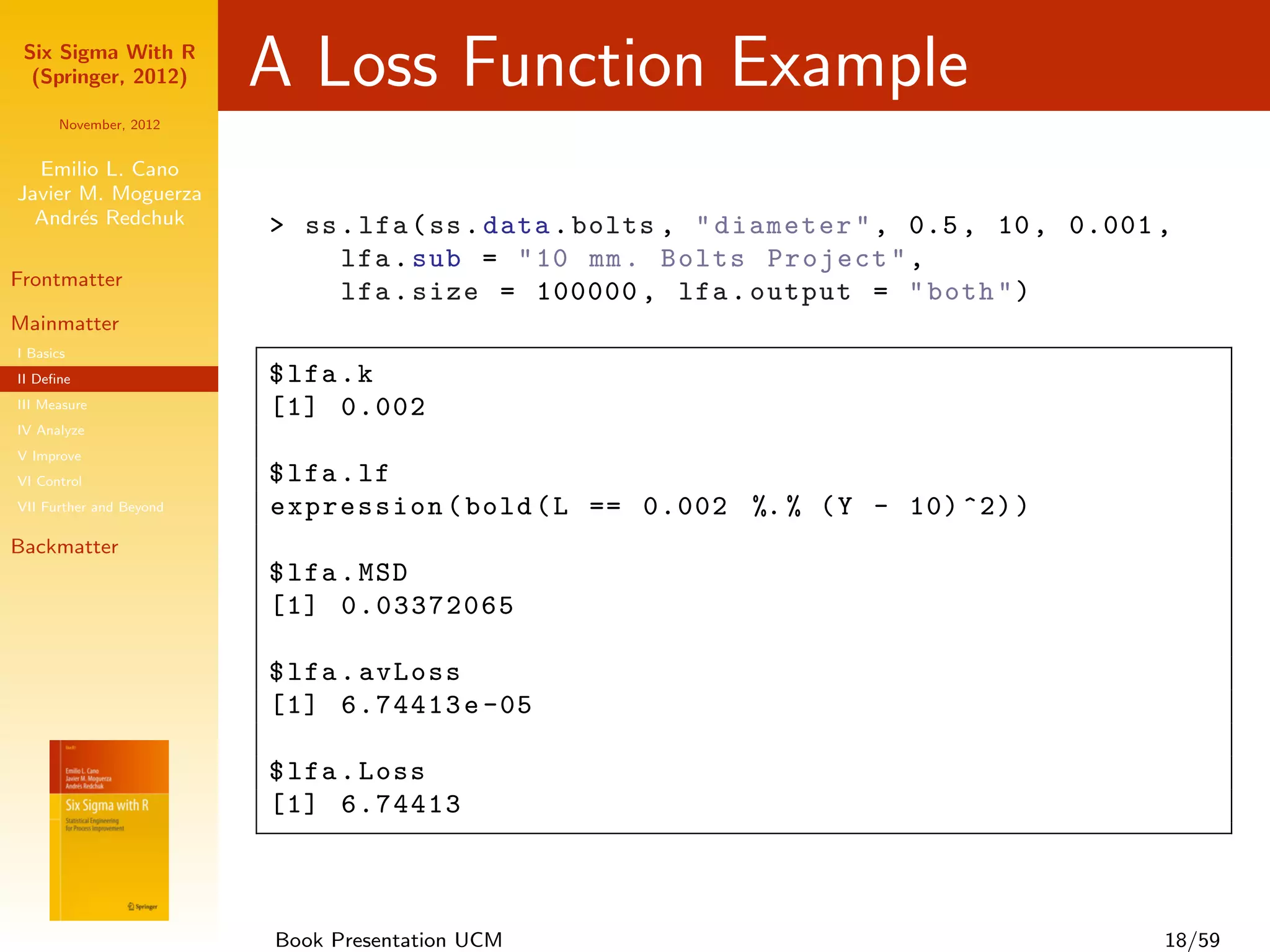

       e                 > ss . lfa ( ss . data . bolts , " diameter " , 0.5 , 10 , 0.001 ,
                              lfa . sub = " 10 mm . Bolts Project " ,
Frontmatter
                              lfa . size = 100000 , lfa . output = " both " )
Mainmatter
I Basics
II Define                 $ lfa . k
III Measure              [1] 0.002
IV Analyze
V Improve
VI Control               $ lfa . lf
VII Further and Beyond   expression ( bold ( L == 0.002 %. % ( Y - 10) ^2) )
Backmatter
                         $ lfa . MSD
                         [1] 0.03372065

                         $ lfa . avLoss
                         [1] 6.74413 e -05

                         $ lfa . Loss
                         [1] 6.74413

                         Book Presentation UCM                                            18/59

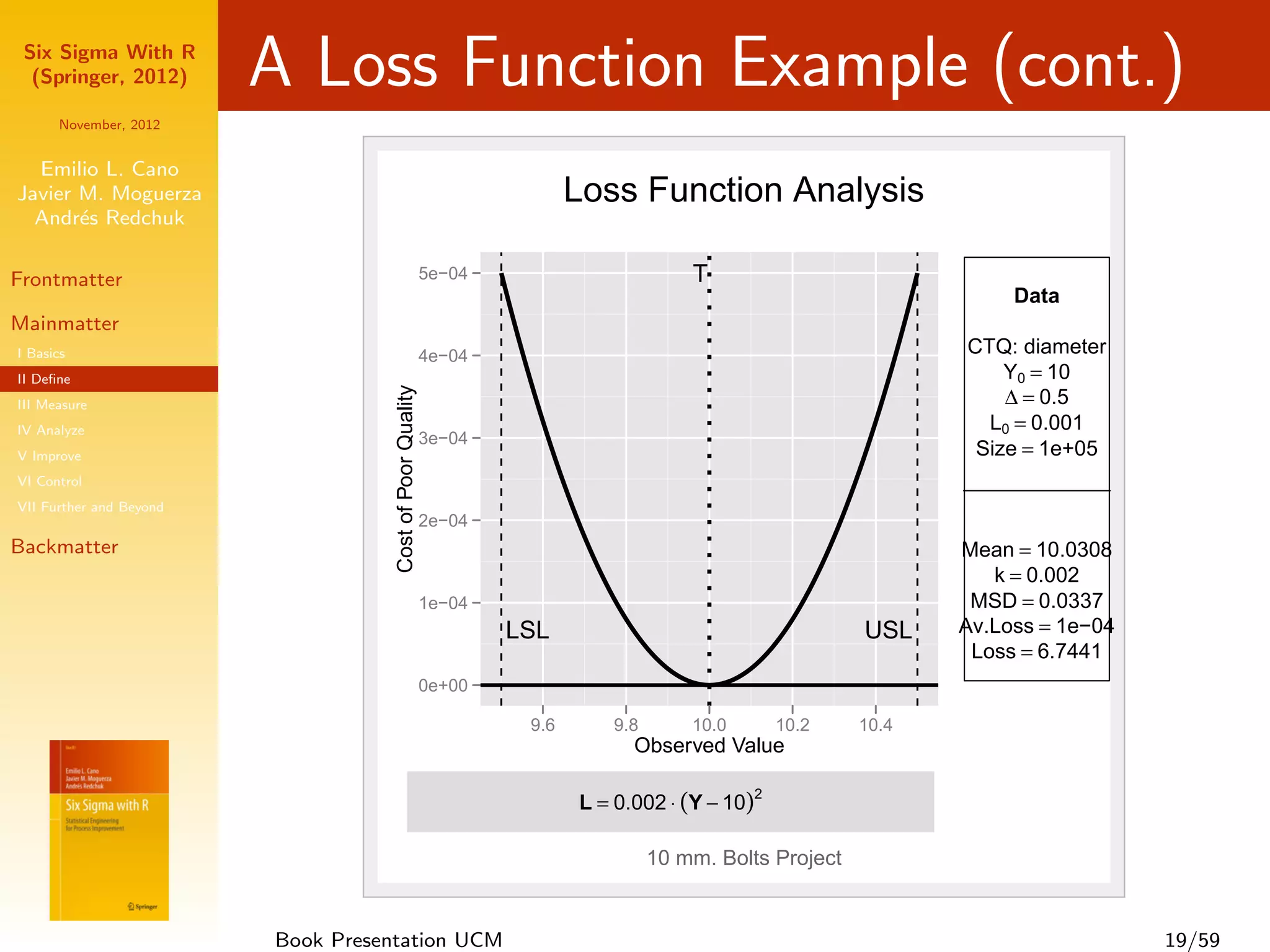

Six Sigma With R
  (Springer, 2012)       A Loss Function Example (cont.)
      November, 2012

  Emilio L. Cano
Javier M. Moguerza                                                        Loss Function Analysis
  Andr´s Redchuk
       e

Frontmatter                                                5e−04                       T
                                                                                                                      Data
Mainmatter
I Basics                                                   4e−04                                                 CTQ: diameter
II Define                                                                                                             Y0 = 10
III Measure                         Cost of Poor Quality                                                             ∆ = 0.5
IV Analyze                                                                                                         L0 = 0.001
                                                           3e−04
V Improve                                                                                                         Size = 1e+05
VI Control
VII Further and Beyond
                                                           2e−04
Backmatter                                                                                                       Mean = 10.0308
                                                                                                                    k = 0.002
                                                           1e−04                                                  MSD = 0.0337
                                                                   LSL                                    USL    Av.Loss = 1e−04
                                                                                                                  Loss = 6.7441
                                                           0e+00

                                                                    9.6      9.8       10.0       10.2    10.4
                                                                                Observed Value

                                                                          L = 0.002 ⋅ (Y − 10)
                                                                                              2

                                                                                   10 mm. Bolts Project

                         Book Presentation UCM                                                                                     19/59
Six Sigma With R
  (Springer, 2012)       5. Measurement System Analysis
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter
                         Lord Kelvin
Mainmatter                                “If you cannot measure it,
I Basics
II Define                                    you cannot improve it.”
III Measure
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter

                         Book Presentation UCM                         20/59
Six Sigma With R
  (Springer, 2012)       Repeatability & Reproducibility
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter

Mainmatter
I Basics

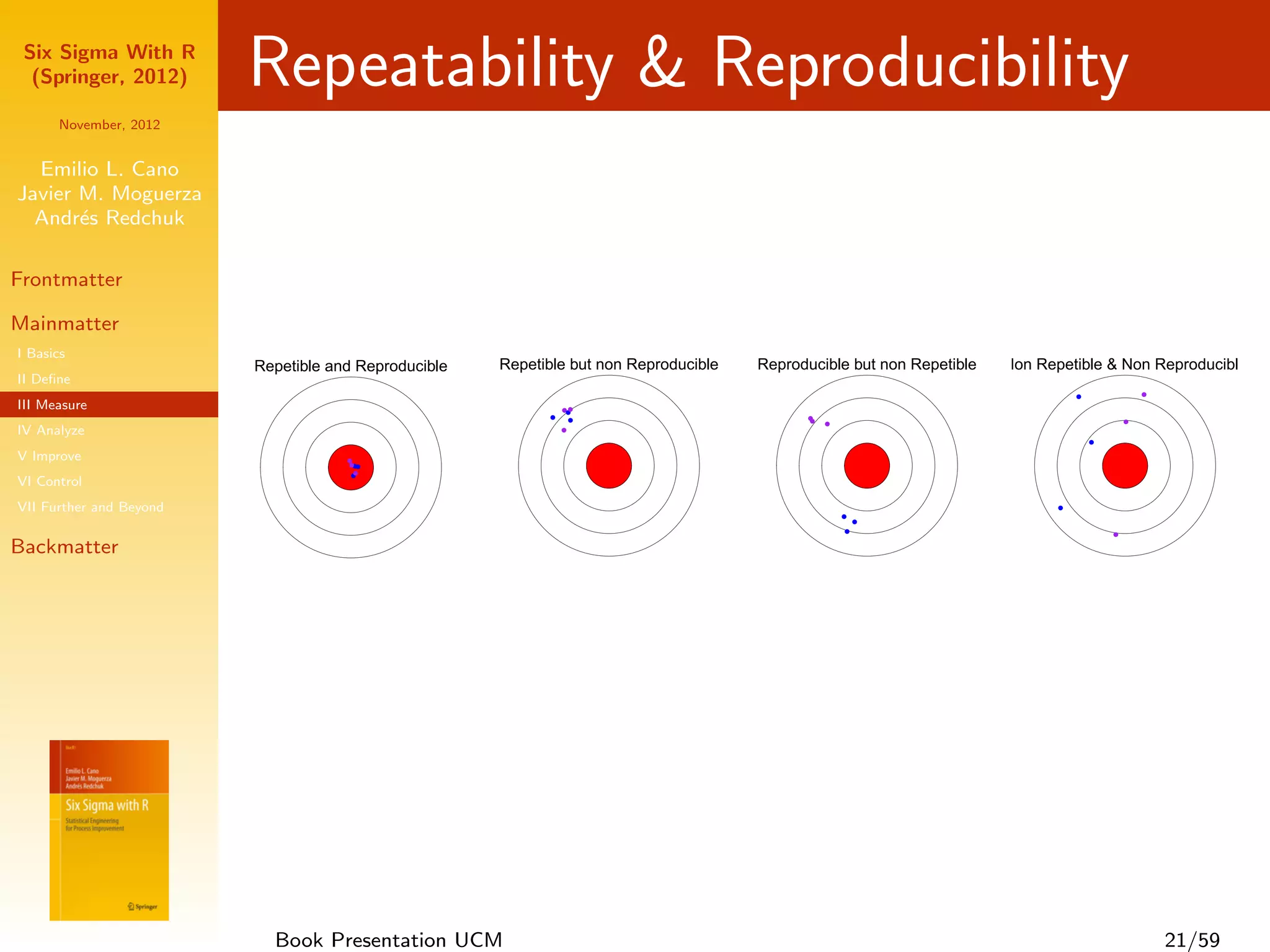

                         Repetible and Reproducible   Repetible but non Reproducible   Reproducible but non Repetible   Non Repetible & Non Reproducible
II Define
                                                                                                                                   q               q
III Measure                                                     qq
                                                                 q
                                                            q    q                           q
                                                                                             q   q                                             q
IV Analyze                                                      q
                                                                                                                                       q

V Improve                            q
                                     qq
                                      q
                                      qq
VI Control
VII Further and Beyond                                                                                                         q
                                                                                                     q
                                                                                                         q
                                                                                                     q                                     q

Backmatter

                           Book Presentation UCM                                                                                                       21/59
Six Sigma With R

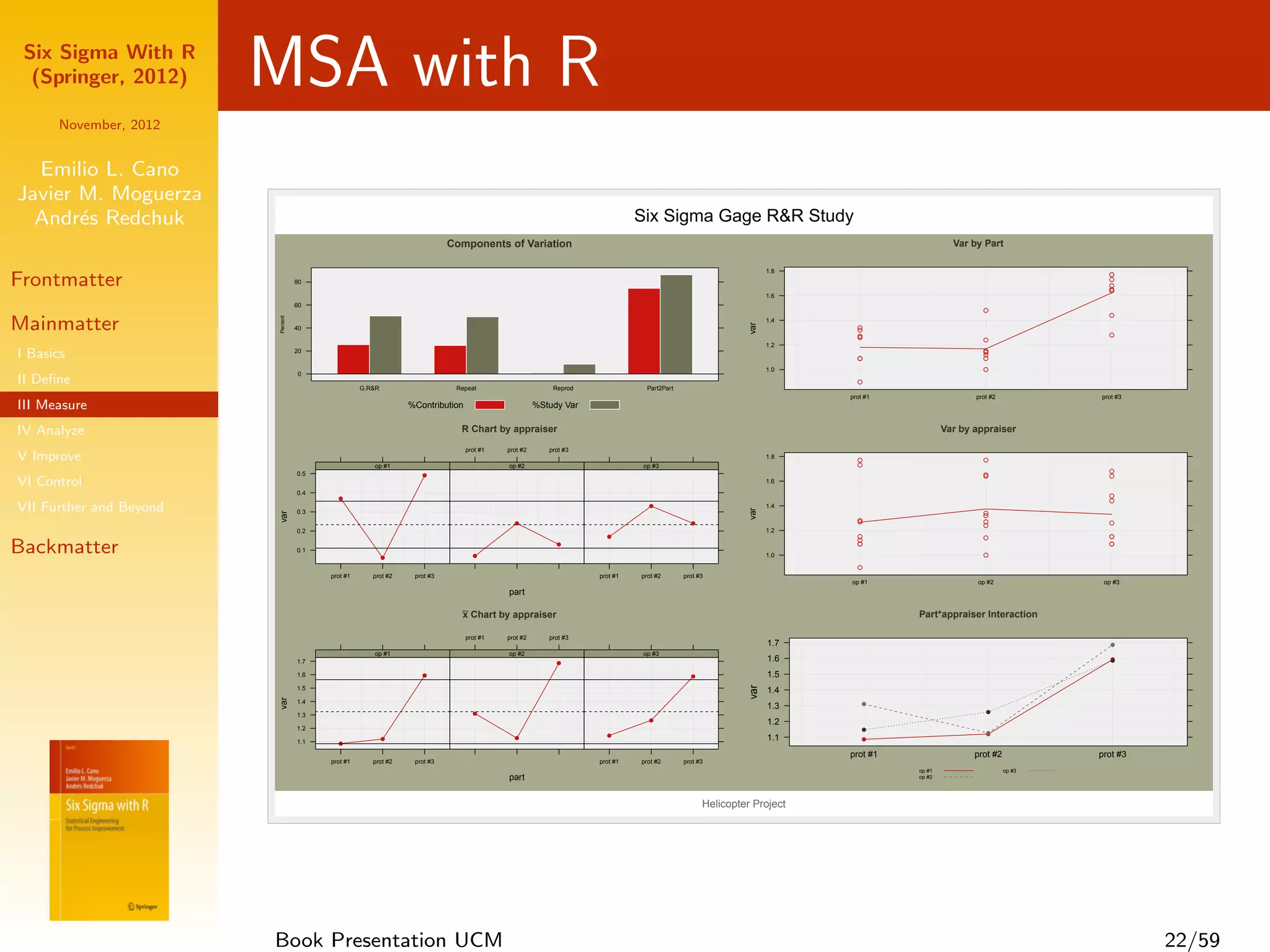

  (Springer, 2012)       MSA with R
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e                                                                                                                   Six Sigma Gage R&R Study
                                                                           Components of Variation                                                                                       Var by Part

                                                                                                                                                               1.8

Frontmatter                        80
                                                                                                                                                                                                                  q
                                                                                                                                                                                                                  q
                                                                                                                                                                                                                  q
                                                                                                                                                                                                                  q
                                                                                                                                                                                                                  q
                                                                                                                                                               1.6
                                   60
                                                                                                                                                                                                q
                                                                                                                                                                                                                  q
                         Percent

Mainmatter                                                                                                                                                     1.4

                                                                                                                                                         var
                                   40                                                                                                                                  q
                                                                                                                                                                       q
                                                                                                                                                                       q
                                                                                                                                                                       q                                          q
                                                                                                                                                                                                q
                                                                                                                                                               1.2
I Basics                           20
                                                                                                                                                                       q
                                                                                                                                                                                                q
                                                                                                                                                                                                q
                                                                                                                                                                                                q
                                                                                                                                                                                                q
                                                                                                                                                               1.0                              q
                                   0
II Define                                           G.R&R                    Repeat                      Reprod               Part2Part
                                                                                                                                                                       q

                                                                                                                                                                     prot #1                  prot #2           prot #3
III Measure                                                     %Contribution                       %Study Var

IV Analyze                                                                   R Chart by appraiser                                                                                      Var by appraiser

                                                                                prot #1   prot #2      prot #3
V Improve                                                                                                                                                      1.8
                                                                                                                                                                       q
                                                                                                                                                                       q
                                                                                                                                                                                                q
                                                      op #1                               op #2                             op #3
                                   0.5                                                                                                                                                                            q
                                                                   q                                                                                                                            q
                                                                                                                                                                                                q                 q
VI Control                                                                                                                                                     1.6
                                   0.4                                                                                                                                                                            q
                                           q                                                                                                                                                                      q
VII Further and Beyond                                                                                                       q                                 1.4

                                                                                                                                                         var
                                   0.3                                                                                                                                                          q
                         var

                                                                                                                                                                                                q
                                                                                            q                                              q                           q
                                                                                                                                                                       q                        q                 q
                                                                                                                                                                                                q
                                   0.2                                                                                                                         1.2
                                                                                                                   q                                                   q                        q                 q
                                                                                                                                                                       q
Backmatter                         0.1
                                                           q                      q
                                                                                                         q
                                                                                                                                                               1.0
                                                                                                                                                                       q
                                                                                                                                                                                                q
                                                                                                                                                                                                                  q

                                                                                                                                                                       q
                                         prot #1      prot #2    prot #3                                         prot #1   prot #2       prot #3
                                                                                                                                                                     op #1                    op #2              op #3
                                                                                          part

                                                                             x Chart by appraiser                                                                              Part*appraiser Interaction

                                                                                prot #1   prot #2      prot #3
                                                                                                                                                               1.7                                                 q
                                                      op #1                               op #2                             op #3
                                   1.7                                                                   q
                                                                                                                                                               1.6                                                 q

                                   1.6                             q                                                                       q                   1.5

                                                                                                                                                         var
                                   1.5                                                                                                                         1.4
                         var

                                   1.4                                                                                                                                   q
                                                                                                                                                               1.3
                                                                                  q                                                                                                              q
                                   1.3
                                                                                                                             q                                 1.2
                                   1.2                                                                                                                                   q
                                                                                                                   q                                                                             q
                                   1.1                     q                                q                                                                  1.1       q
                                           q
                                                                                                                                                                     prot #1                  prot #2           prot #3
                                         prot #1      prot #2    prot #3                                         prot #1   prot #2       prot #3
                                                                                                                                                                               op #1                    op #3
                                                                                          part                                                                                 op #2

                                                                                                                                               Helicopter Project

                         Book Presentation UCM                                                                                                                                                                            22/59
Six Sigma With R
  (Springer, 2012)       6. Pareto Analysis with R
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter
                         Ovidio
Mainmatter
I Basics
                         Causa latet: vis est notissima. [The cause is
II Define
III Measure
                         hidden, but the result is known.]
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter

                         Book Presentation UCM                           23/59
Six Sigma With R
  (Springer, 2012)       Pareto Principle (80/20 rule)
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter

Mainmatter
I Basics
II Define
                         Examples
III Measure
IV Analyze
V Improve
                                 20 % of customers make 80 % of incomes
VI Control
VII Further and Beyond           20 % of students get 80 % of good marks
Backmatter
                                 80 % of cost of quality is due to 20 % of
                                 the possible causes

                         Book Presentation UCM                         24/59
Six Sigma With R

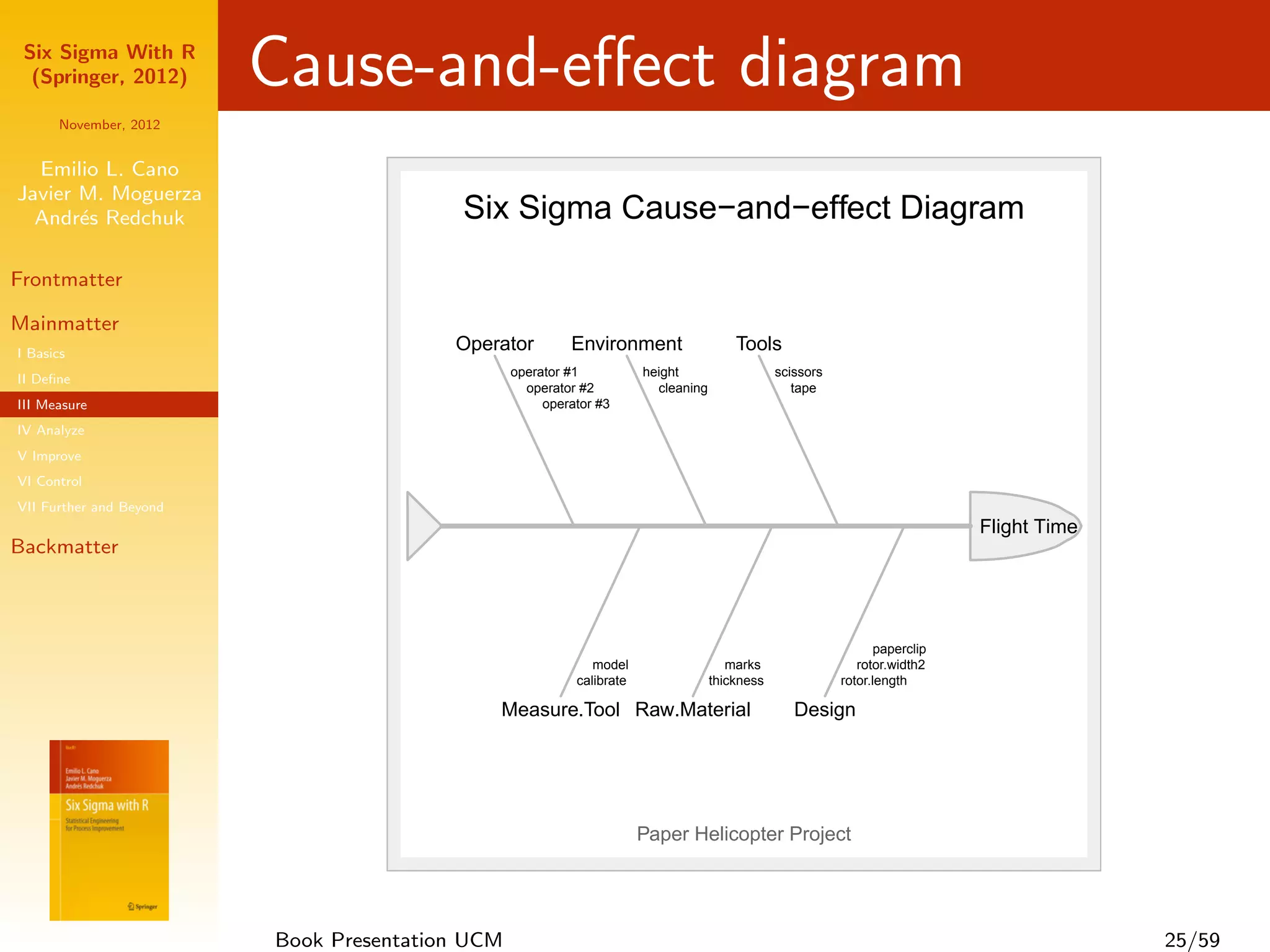

  (Springer, 2012)       Cause-and-effect diagram
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e                                  Six Sigma Cause−and−effect Diagram

Frontmatter

Mainmatter
I Basics
                                         Operator         Environment                   Tools
                                                 operator #1           height                   scissors
II Define
                                                   operator #2           cleaning                  tape
III Measure                                           operator #3
IV Analyze
V Improve
VI Control
VII Further and Beyond
                                                                                                                              Flight Time
Backmatter

                                                                                                                  paperclip
                                                              model                    marks                  rotor.width2
                                                           calibrate                thickness              rotor.length

                                             Measure.Tool Raw.Material                             Design

                                                                       Paper Helicopter Project

                         Book Presentation UCM                                                                                              25/59
Six Sigma With R

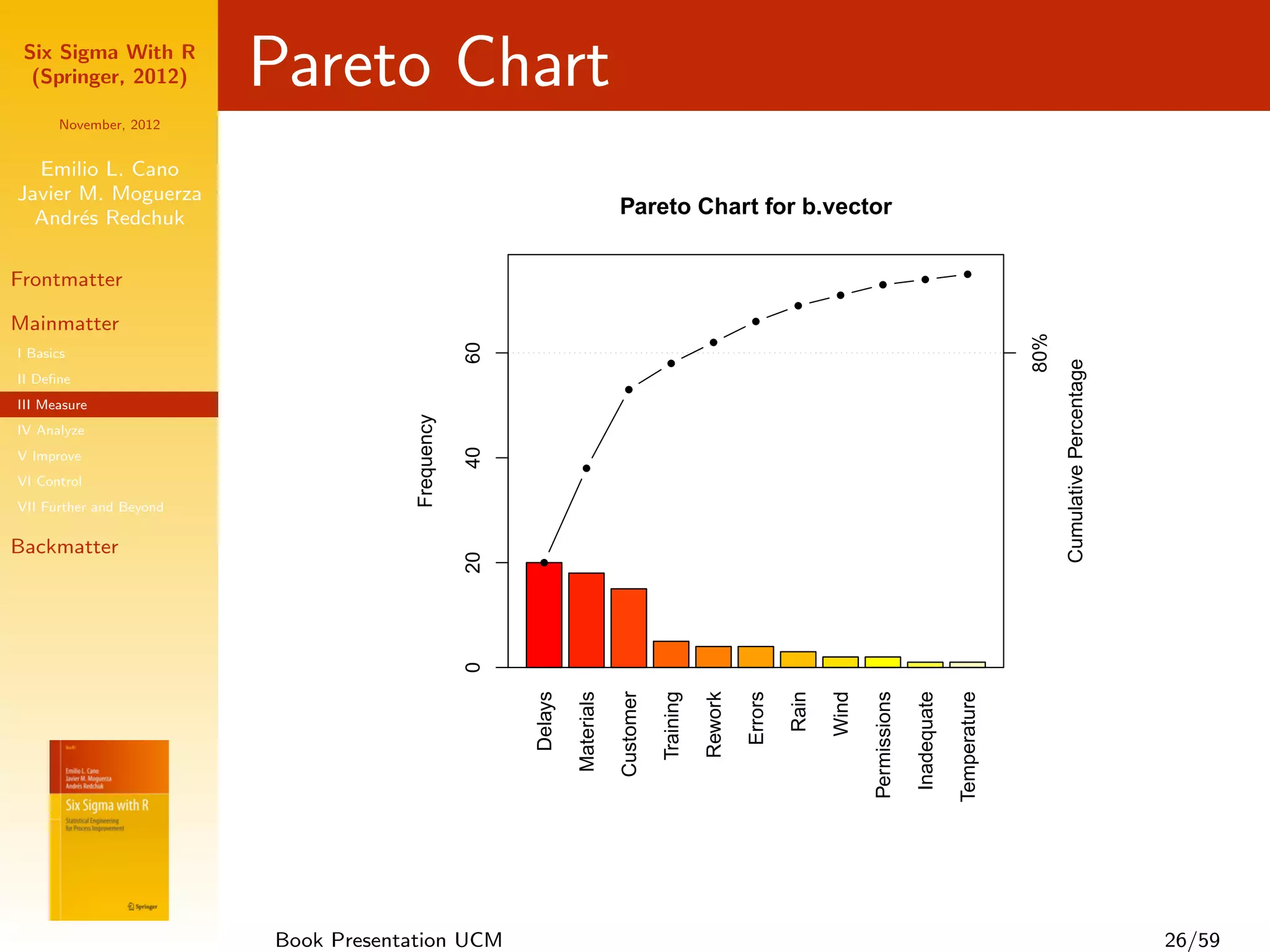

  (Springer, 2012)       Pareto Chart
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e                                                                    Pareto Chart for b.vector

                                                                                                                                                               q
Frontmatter                                                                                                                         q
                                                                                                                                                  q
                                                                                                                           q
                                                                                                                    q

Mainmatter                                                                                                  q

                                                                                                                                                                           80%
                                                                                                   q

                                                  60
I Basics

                                                                                                                                                                                 Cumulative Percentage
                                                                                        q
II Define
                                                                             q
III Measure
IV Analyze                            Frequency

                                                  40
V Improve
                                                                 q
VI Control
VII Further and Beyond

Backmatter
                                                  20

                                                        q
                                                  0

                                                       Delays

                                                                Materials

                                                                            Customer

                                                                                       Training

                                                                                                  Rework

                                                                                                           Errors

                                                                                                                    Rain

                                                                                                                           Wind

                                                                                                                                  Permissions

                                                                                                                                                Inadequate

                                                                                                                                                             Temperature
                         Book Presentation UCM                                                                                                                                                           26/59
Six Sigma With R
  (Springer, 2012)       7. Process Capability Analysis
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter
                         Johann Wolfgang von Goethe
Mainmatter               One cannot develop taste from what is of
I Basics
II Define
III Measure
                         average quality but only from the very best.
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter

                         Book Presentation UCM                      27/59
Six Sigma With R

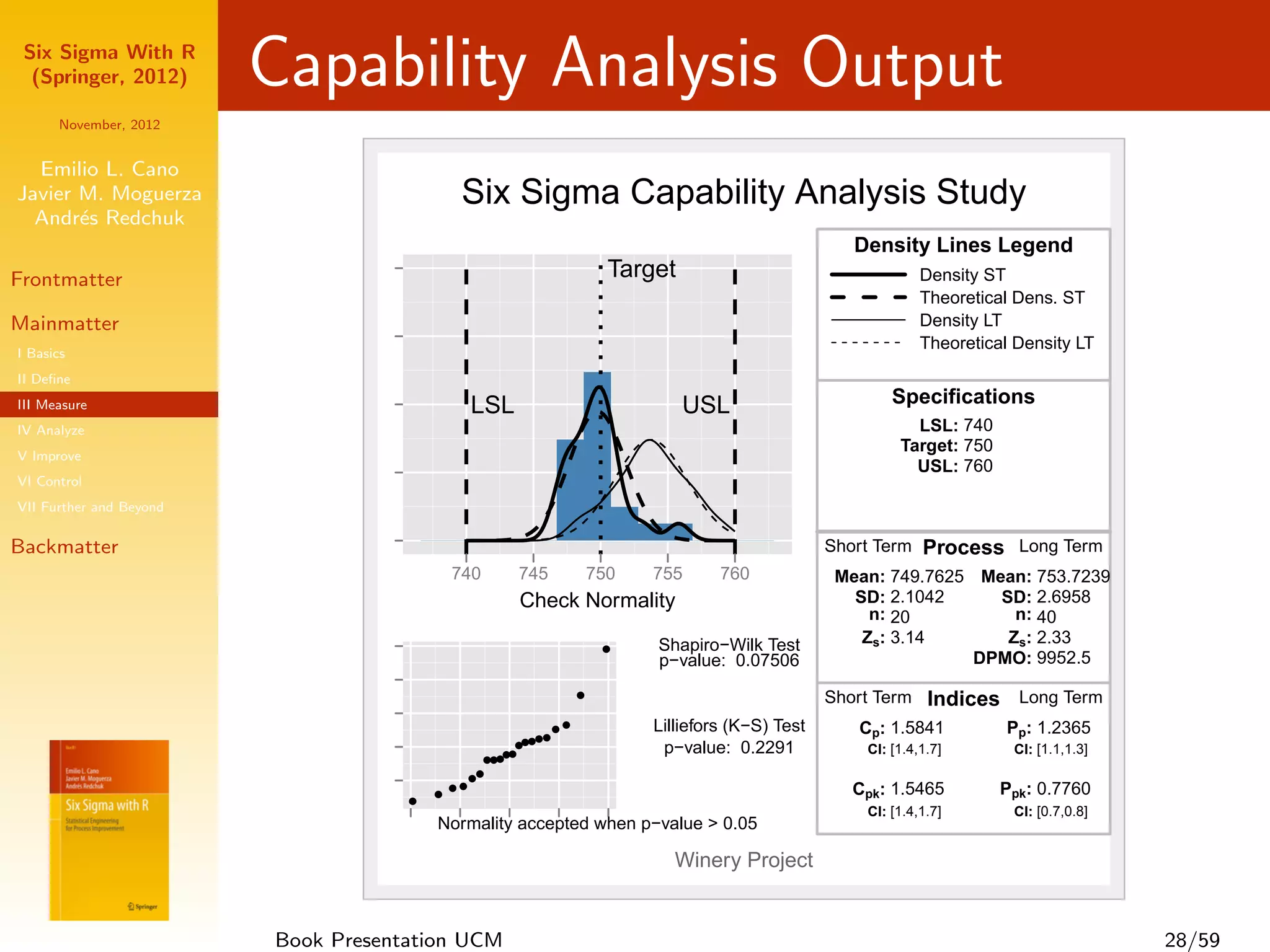

  (Springer, 2012)       Capability Analysis Output
      November, 2012

  Emilio L. Cano
Javier M. Moguerza                            Six Sigma Capability Analysis Study
  Andr´s Redchuk
       e
                                                      Histogram & Density                                  Density Lines Legend
Frontmatter                                                                 Target                                   Density ST
                                                                                                                     Theoretical Dens. ST
Mainmatter                                                                                                           Density LT
                                                                                                                     Theoretical Density LT
I Basics
II Define
III Measure                                       LSL                                USL                        Specifications
IV Analyze                                                                                                         LSL: 740
                                                                                                                 Target: 750
V Improve
                                                                                                                   USL: 760
VI Control
VII Further and Beyond

Backmatter                                                                                              Short Term   Process Long Term
                                             740         745              750   755      760             Mean: 749.7625 Mean: 753.7239
                                                         Check Normality                                   SD: 2.1042     SD: 2.6958
                                                                                                             n: 20          n: 40
                                                                                Shapiro−Wilk Test           Zs: 3.14       Zs: 2.33
                                                                           q
                                                                                p−value: 0.07506                        DPMO: 9952.5
                                                                      q                                 Short Term    Indices Long Term
                                                                 qq             Lilliefors (K−S) Test      Cp: 1.5841          Pp: 1.2365
                                                            qq
                                                         qqq                     p−value: 0.2291            CI: [1.4,1.7]       CI: [1.1,1.3]
                                                       qq
                                                    qqq
                                                  qq
                                             qq                                                            Cpk: 1.5465         Ppk: 0.7760
                                         q
                                     q
                                                                                                            CI: [1.4,1.7]       CI: [0.7,0.8]
                                         Normality accepted when p−value > 0.05

                                                                                  Winery Project

                         Book Presentation UCM                                                                                                  28/59
Six Sigma With R
  (Springer, 2012)       8. Charts with R
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e
                         John Tukey
Frontmatter

Mainmatter
                           “The greatest value of a picture is when it
I Basics
II Define
                         forces us to notice what we never expected to
III Measure
IV Analyze                                    see.”
V Improve
VI Control
VII Further and Beyond

Backmatter

                         Book Presentation UCM                     29/59
Six Sigma With R
  (Springer, 2012)       Multi-vari chart
      November, 2012

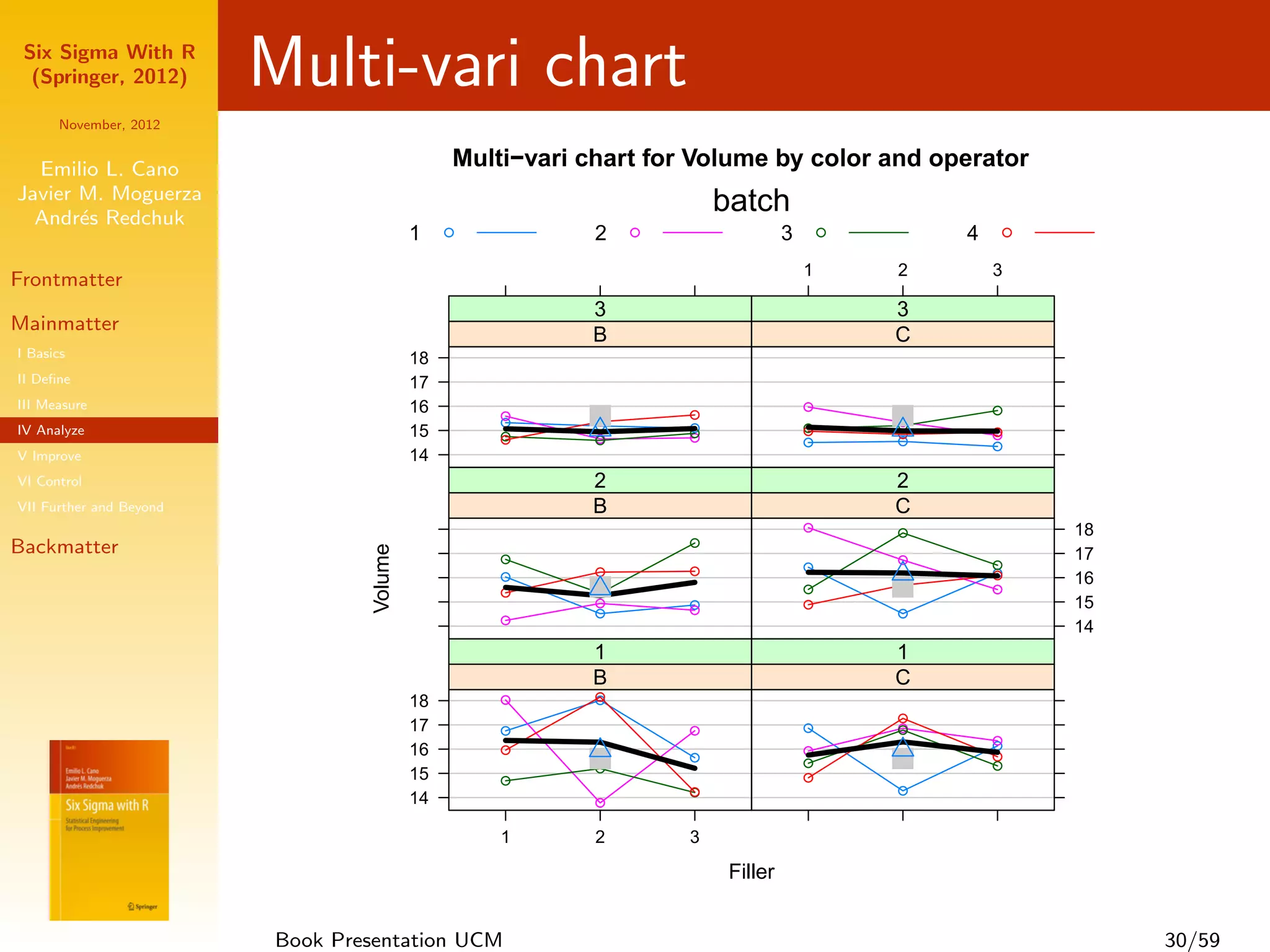

  Emilio L. Cano                                Multi−vari chart for Volume by color and operator
Javier M. Moguerza
  Andr´s Redchuk
       e
                                                                        batch
                                           1    q           2   q                 3       q       4       q

                                                                                      1       2       3
Frontmatter
                                                           3                                  3
Mainmatter
                                                           B                                  C
I Basics                                   18
II Define                                   17
III Measure                                16                                         q               q
                                                    q               q
                                                    q       q
                                                            q                                 q
                                                                                              q
IV Analyze                                 15                       q
                                                                    q                 q
                                                                                      q               q
                                                    q
                                                    q               q                         q       q
                                                            q                         q       q       q
V Improve                                  14
VI Control                                                 2                                  2
VII Further and Beyond                                     B                                  C
                                                                                      q       q               18
                                                                    q
Backmatter
                                  Volume

                                                    q                                         q               17
                                                                                      q               q
                                                            q       q                                 q
                                                    q
                                                                                              q               16
                                                    q       q                         q               q
                                                            q       q
                                                                    q                 q                       15
                                                            q                                 q
                                                    q
                                                                                                              14
                                                           1                                  1
                                                           B                                  C
                                                            q
                                           18       q       q
                                                                                              q
                                           17       q               q                 q       q
                                                                                                      q
                                                                                                      q
                                           16       q
                                                                    q
                                                                                      q               q
                                                            q                         q               q
                                           15       q                                 q
                                                                    q                         q
                                           14               q

                                                    1       2       3

                                                                         Filler

                         Book Presentation UCM                                                                     30/59
Six Sigma With R
  (Springer, 2012)       9. Statistics and Probability with R
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter

Mainmatter               Aaron Levenstein
I Basics
II Define                 “Statistics are like bikinis. What they reveal is
III Measure
IV Analyze
V Improve
                           suggestive, but what they conceal is vital.”
VI Control
VII Further and Beyond

Backmatter

                         Book Presentation UCM                         31/59
Six Sigma With R
  (Springer, 2012)       Distributions
      November, 2012

  Emilio L. Cano                                                     Hypergeometric                                                         Geometric                                        Negative Binomial                                                        Poison
Javier M. Moguerza

                                 Probability

                                                                                                 Probability

                                                                                                                                                             Probability

                                                                                                                                                                                                                         Probability
                                                                                                                                                                                   0.06

                                                                                                                                                                                                                                               0.15
                                                                                                                         0.00 0.10
  Andr´s Redchuk
       e

                                                       0.3

                                                                                                                                                                                   0.00

                                                                                                                                                                                                                                               0.00
                                                       0.0
Frontmatter                                                          0      1     2    3     4                                          0    10    30                                               10 20 30 40                                              0        5   10    20

                                                                     Elements in class A                               Items extracted until first success                         Number of trials until 3 events
                                                                                                                                                                                                                 Number of successful experiments per unit
Mainmatter
I Basics                                                                 Exponential                                                        Lognormal                                                   Uniform                                                       Gamma
                                 Probability Density

                                                                                                 Probability Density

                                                                                                                                                             Probability Density

                                                                                                                                                                                                                         Probability Density
II Define

                                                                                                                         0.0 0.4 0.8

                                                                                                                                                                                   0.0 0.6 1.2

                                                                                                                                                                                                                                               0.0 0.2 0.4
III Measure                                            0.6

IV Analyze
                                                       0.0

V Improve
                                                                     0 1 2 3 4 5                                                        0     2   4     6                                        −0.5     0.5      1.5                                       0 2 4 6 8
VI Control
                                                                     Random Variable X                                                 Random Variable X>0                                        Random Variable X                                          Random Variable X
VII Further and Beyond

Backmatter                                                                      Beta                                                         Weibul                                                 t−Student                                                Chi−squared
                                 Probability Density

                                                                                                 Probability Density

                                                                                                                                                             Probability Density

                                                                                                                                                                                                                         Probability Density
                                                       0.0 1.0 2.0

                                                                                                                         0.0 0.3 0.6

                                                                                                                                                                                                                                               0.06
                                                                                                                                                                                   0.3
                                                                                                                                                                                                          95%
                                                                                                                                                                                                              5%                                                      95% 5%

                                                                                                                                                                                                                                               0.00
                                                                                                                                                                                   0.0
                                                                                                                                                                                                            1.73                                                        30.14
                                                                     0.0        0.4    0.8                                              0     2   4     6                                          −4      0 2 4                                                 10       30    50

                                                                     Random Variable X                                                  Random Variable X                                         Random Variable X                                          Random Variable X

                                                                                  F
                                 Probability Density

                                                       0.6

                                                                           95%
                                                                                     5%
                                                       0.0

                                                                                  2.34
                                                                     0      1     2    3     4

                                                                     Random Variable X

                         Book Presentation UCM                                                                                                                                                                                                                                       32/59
Six Sigma With R
  (Springer, 2012)       10. Statistical Inference with R
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e
                         George E.P. Box
Frontmatter

Mainmatter
                             “All models are wrong; some models are
I Basics
II Define
                                             useful.”
III Measure
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter

                         Book Presentation UCM                        33/59
Six Sigma With R
  (Springer, 2012)       Confidence Interval Example
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e                                                 Confidence Interval for the Mean

Frontmatter
                                      Mean:                    950.016
                                                                                     95% CI:            [949.967, 950.064]
Mainmatter                            StdDev:                    0.267
                                                                                     P−Var:                       unknown
I Basics                              n:                           120
                                                                                     t:                               1.98
II Define                              Missing:                       0
III Measure
IV Analyze
V Improve
VI Control                                               Histogram & Density Plot                       Shapiro−Wilks
                                                 1.5
VII Further and Beyond                                                                                  Normality Test

Backmatter                                                                                                  0.985
                                                                                                         p−value: 0.19
                                                 1.0
                                       density

                                                                                                     Normal q−q Plot
                                                 0.5                                                                                        q
                                                                                                                                     qq q
                                                                                                                               qq
                                                                                                                              qq qq q
                                                                                                                                qq q
                                                                                                                                 qq
                                                                                                                              qq
                                                                                                                             qq
                                                                                                                             qq
                                                                                                                            qq
                                                                                                                           qq
                                                                                                                           qq
                                                                                                                           qq
                                                                                                                          qq
                                                                                                                          qq
                                                                                                                         qq
                                                                                                                         qq
                                                                                                                        qq
                                                                                                                        qq
                                                                                                                       q
                                                                                                                       q
                                                                                                                      qq
                                                                                                                     qq
                                                                                                                     qq
                                                                                                                    qq
                                                                                                                  qq
                                                                                                                 qq
                                                                                                                 qq
                                                                                                                   q
                                                 0.0                                                            qq
                                                                                                               qq
                                                                                                              qqqq
                                                                                                              qq
                                                                                                             qq
                                                                                                             qq
                                                                                                              q
                                                                                                            qq
                                                                                                           qq
                                                                                                           qq
                                                                                                          qq
                                                                                                             q
                                                                                                         qq
                                                                                                         qq
                                                                                                        qq
                                                       949.0   949.5   950.0     950.5                 q
                                                                                                       q
                                                                                                      q
                                                                                                     q
                                                                  Value of len                 q
                                                                                                   qq

                         Book Presentation UCM                                                                                                  34/59
Six Sigma With R
  (Springer, 2012)       11. Design of Experiments with R
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter
                         R.A. Fisher
Mainmatter                      “Sometimes the only thing you can
I Basics
II Define                        do with a poorly designed
III Measure
IV Analyze
V Improve
                                experiment is to try to find out what
VI Control
VII Further and Beyond
                                it died of”
Backmatter

                         Book Presentation UCM                         35/59
Six Sigma With R
  (Springer, 2012)       The Importance of Experimenting
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter
                                 “An engineer who does not know
Mainmatter                       experimental design is not an
I Basics
II Define
III Measure
                                 engineer”
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter
                         Comment made by to one
                         of the authors [of “Statistics
                         for experimenters” by an
                                            ]
                         executive of the Toyota
                         Motor Company.

                          Book Presentation UCM                   36/59
Six Sigma With R
  (Springer, 2012)       12.Process Control with R
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter

Mainmatter
                         Walter A. Shewhart
I Basics
II Define
                         “Special causes of variation may be found and
III Measure
IV Analyze                                eliminated.”
V Improve
VI Control
VII Further and Beyond

Backmatter

                         Book Presentation UCM                     37/59
Six Sigma With R
  (Springer, 2012)       Control Chart Plotting
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e                                                                                                   p Chart
                                                                                                        for stockouts

                                                                 0.25
Frontmatter                                                                                                     q
                                                                                                                q

                                                                                                                                                                      UCL
Mainmatter                                                                  q
                                                                                    q

                                                                 0.20
I Basics

                                      Group summary statistics
II Define
                                                                                                                         q
III Measure

                                                                 0.15
                                                                                                                                           q             q
                                                                        q                   q
IV Analyze
                                                                                                                                  q

V Improve                                                                                                                              q        q

VI Control
                                                                 0.10
                                                                                q
                                                                                                            q
                                                                                                                                                                      CL
                                                                                                                                                    q
VII Further and Beyond
                                                                                                    q
                                                                                                                                                             q

Backmatter                                                                                      q                                                                 q
                                                                 0.05

                                                                                                        q
                                                                                                                     q        q

                                                                                        q
                                                                                                                                                                      LCL
                                                                 0.00

                                                                        1       3       5       7       9       11       13       15       17       19       21

                                                                                                                Group

                                                                    Number of groups = 22
                                                                    Center = 0.1212294    LCL is variable                         Number beyond limits = 1
                                                                    StdDev = 0.3263936    UCL is variable                         Number violating runs = 0

                         Book Presentation UCM                                                                                                                              38/59
Six Sigma With R
  (Springer, 2012)       13. Other Tools and
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
                         Methodologies
  Andr´s Redchuk
       e

Frontmatter

Mainmatter
                         Johann Wolfgang von Goethe
I Basics
II Define                 Instruction does much, but encouragement
III Measure
IV Analyze
V Improve
                         everything.
VI Control
VII Further and Beyond

Backmatter

                         Book Presentation UCM                      39/59
Six Sigma With R
  (Springer, 2012)       Other topics
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter

Mainmatter
I Basics
                                 Failure Mode, Effects, and Criticality
II Define
III Measure
                                 Analysis
IV Analyze
V Improve
VI Control
                                 Design for Six Sigma
VII Further and Beyond

Backmatter
                                 Lean
                                 Gantt Chart
                                 Some Advanced R Topics

                         Book Presentation UCM                           40/59
Six Sigma With R
  (Springer, 2012)       Contents
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e                 1   Frontmatter
Frontmatter

Mainmatter
                         2   Mainmatter
I Basics
II Define                      I Basics
III Measure
IV Analyze
V Improve
                              II Define
VI Control
VII Further and Beyond
                              III Measure
Backmatter                    IV Analyze
                              V Improve
                              VI Control
                              VII Further and Beyond
                         3   Backmatter

                         Book Presentation UCM         41/59
Six Sigma With R
  (Springer, 2012)       Case Study
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter

Mainmatter
I Basics
II Define
III Measure
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter

                         Book Presentation UCM   42/59
Six Sigma With R
  (Springer, 2012)       Helicopter Template
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter

Mainmatter
I Basics
II Define
III Measure
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter

                         > ss . heli ()

                         null device
                                   1

                         > # vignette (" H e l i c o p t e r I n s t r u c t i o n s ") to get
                              instructions

                         Book Presentation UCM                                                   43/59
Six Sigma with R | Paper Helicopter template
                                                                                   max
                                                                                   (9.5cm)

                                                                                   std
                                                                                   (8cm)

                                                                                   min
                                                                                   (6.5cm)

                                                                                ← wings length →
                                              cut
                                         ?
                                     pe
            fold ↑                                             fold ↓

                                    ta
cut

      cut                                                                 cut

                                                                                ← body length →
                            tape?

                                                    tape?

                                                                                   min
                                                                                   (6.5cm)

                                                                                   std
                 fold ↓ ↓

                                                             fold ↑ ↑

                                                                                   (8cm)

                                          clip?                                    max
             max        min   ← body width →           min         max             (9.5cm)
             (6cm)    (4cm)                         (4cm)         (6cm)
Six Sigma With R
  (Springer, 2012)       Enjoy the Case Study!
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter

Mainmatter
I Basics
II Define
III Measure
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter

                         Book Presentation UCM   45/59
Six Sigma With R
  (Springer, 2012)       Enjoy the Case Study!
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter

Mainmatter
I Basics
II Define
III Measure
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter

                         Book Presentation UCM   45/59
Six Sigma With R
  (Springer, 2012)       So what?
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter

Mainmatter
I Basics
II Define
III Measure
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter

                         Book Presentation UCM   46/59
Six Sigma With R
  (Springer, 2012)       So what?
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e                 The Scientific Method
Frontmatter

Mainmatter
I Basics
II Define
III Measure
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter

                         Book Presentation UCM   46/59
Six Sigma With R
  (Springer, 2012)       The Scientific Method and Six
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
                         Sigma
  Andr´s Redchuk
       e

Frontmatter

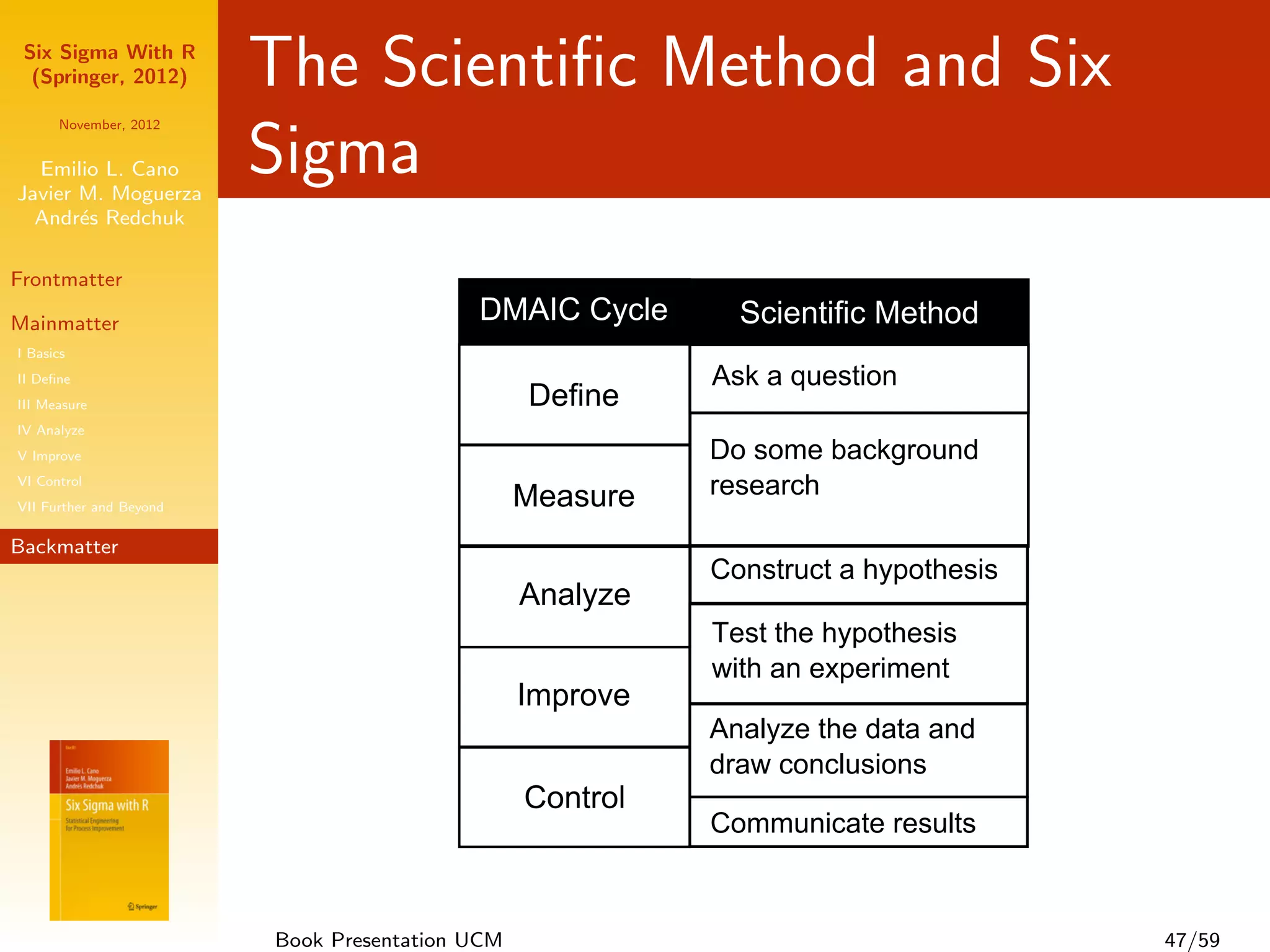

Mainmatter                                 DMAIC Cycle       Scientific Method
I Basics
II Define                                                   Ask a question
III Measure                                      Define
IV Analyze
V Improve                                                  Do some background
VI Control
                                                 Measure   research
VII Further and Beyond

Backmatter
                                                           Construct a hypothesis
                                                 Analyze
                                                           Test the hypothesis
                                                           with an experiment
                                                 Improve
                                                           Analyze the data and
                                                           draw conclusions
                                                 Control
                                                           Communicate results

                         Book Presentation UCM                                      47/59
Six Sigma With R
  (Springer, 2012)       The Key to Success
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
                         “Six Sigma speaks the language of business”
  Andr´s Redchuk
       e

Frontmatter                                         ISO 13053-1:2011
Mainmatter
I Basics
II Define
III Measure
IV Analyze
                         Six Sigma methodology is a quality paradigm
V Improve
VI Control
                         that translates the involved scientific
VII Further and Beyond

Backmatter
                         methodology into a simple way to apply the
                         scientific method within every organization.

                         Book Presentation UCM                     48/59
Six Sigma With R
  (Springer, 2012)       Opportunities
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter
                                 For Today’s Graduate, Just One Word: Statistics
Mainmatter                       (The New York Times, August 2009)
I Basics
II Define                              “I keep saying that the sexy job in the
III Measure
IV Analyze                            next 10 years will be statisticians”
V Improve
VI Control
VII Further and Beyond

Backmatter                       Data Scientist: The Sexiest Job of the 21st
                                 Century (Harvard Business Review, October 2012)
                                      . . . the “data scientist.” It’s a
                                      high-ranking professional with the
                                      training and curiosity to make
                                      discoveries in the world of big data . . .

                         Book Presentation UCM                                49/59
Six Sigma With R
  (Springer, 2012)       Opportunities (cont.)
      November, 2012

  Emilio L. Cano                 Gartner Sees 4.4M Big Data Jobs by 2015
Javier M. Moguerza
  Andr´s Redchuk
       e                         (Information Management, October 2012)
Frontmatter                      Lack of data scientists could derail big data
Mainmatter
I Basics
                                 projects: IBM (CIO, October 2012)
II Define
III Measure
IV Analyze
                                 Son las matem´ticas, est´pido (El Pa´
                                              a          u           ıs,
V Improve
VI Control
                                 Noviembre 2012)
VII Further and Beyond

Backmatter
                                          La econom´ del conocimiento exige
                                                    ıa
                                          una educaci´n sustentada en tres
                                                     o
                                          fundamentos: un nivel avanzado en
                                          matem´tica y estad´
                                                 a           ıstica, una
                                          capacidad elevada para escribir un
                                          argumento y un nivel avanzado de
                                          ingl´s
                                              e

                         Book Presentation UCM                                   50/59
Six Sigma With R
  (Springer, 2012)       R Final Remarks
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter

Mainmatter
I Basics
II Define
III Measure
IV Analyze
V Improve
VI Control
VII Further and Beyond

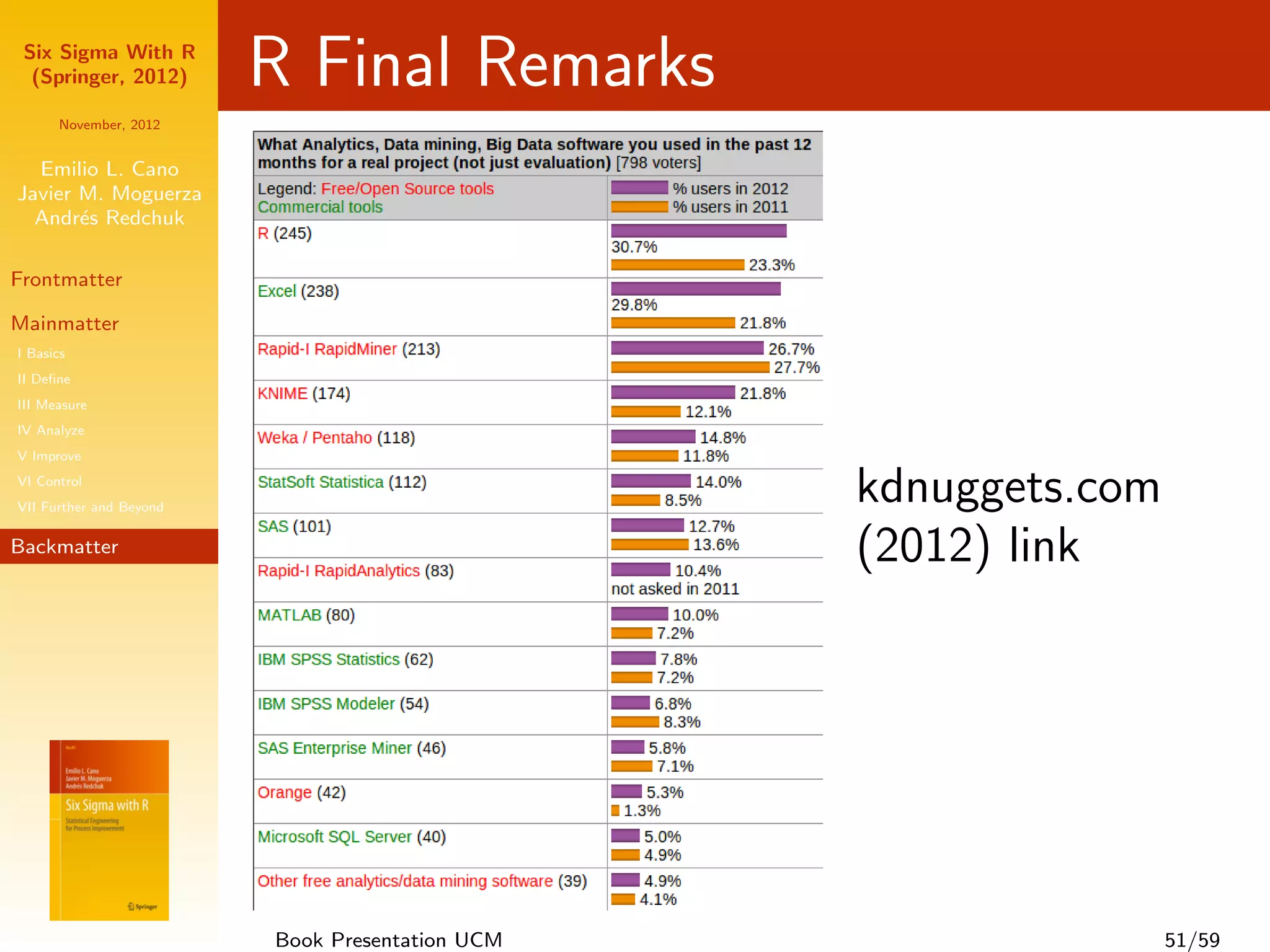

                                                 kdnuggets.com
Backmatter                                       (2012) link

                         Book Presentation UCM                   51/59
Six Sigma With R
  (Springer, 2012)       R Final Remarks (cont.)
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
                         Community
  Andr´s Redchuk
       e
                                 4131 packages at CRAN (18/11/2012)
Frontmatter

Mainmatter                       Task views
I Basics
II Define
III Measure
                                 Manuals
IV Analyze
V Improve                        Publications
VI Control
VII Further and Beyond

Backmatter               http:
                         //cran.r-project.org/web/packages/

                         Book Presentation UCM                    52/59
Six Sigma With R
  (Springer, 2012)       R Final Remarks (cont.)
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e
                         Customization
                         A company can develop a package that fits its
Frontmatter

Mainmatter
                         inner procedures and methods.
I Basics
II Define
III Measure
IV Analyze
V Improve
                         Innovation
VI Control
VII Further and Beyond
                         A company can develop and deploy an
Backmatter               innovative method from its R&D department,
                         or from the result of other published
                         researches.

                         Book Presentation UCM                    53/59
Six Sigma With R
  (Springer, 2012)       R Final Remarks (cont.)
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter              Business
Mainmatter
I Basics
                                 http:
II Define
III Measure
                                 //www.revolutionanalytics.com/
IV Analyze
V Improve
VI Control
                                 http://www.openanalytics.eu/
VII Further and Beyond

Backmatter
                                 http://www.fellstat.com/
                                 http://www.rstudio.com/ide/
                                 http://www.datanalytics.com/
                                 ...

                         Book Presentation UCM                    54/59
Six Sigma With R
  (Springer, 2012)       R Final Remarks (cont.)
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter

Mainmatter
I Basics
                         GUI, IDE
II Define
III Measure
                                 RStudio
IV Analyze
V Improve
VI Control
                                 Eclipse + StatET
VII Further and Beyond

Backmatter
                                 EMACS + EES
                                 Deducer
                                 ...

                         Book Presentation UCM      55/59
Six Sigma With R
  (Springer, 2012)       R Final Remarks (cont.)
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter

Mainmatter
I Basics
II Define
III Measure
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter

                         Book Presentation UCM     56/59
Six Sigma With R
  (Springer, 2012)

      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter

Mainmatter
I Basics
II Define
III Measure
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter

                                                 http://r-es.org/

                         Book Presentation UCM                      57/59
Six Sigma With R
  (Springer, 2012)

      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

Frontmatter

Mainmatter
I Basics
II Define
III Measure
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter

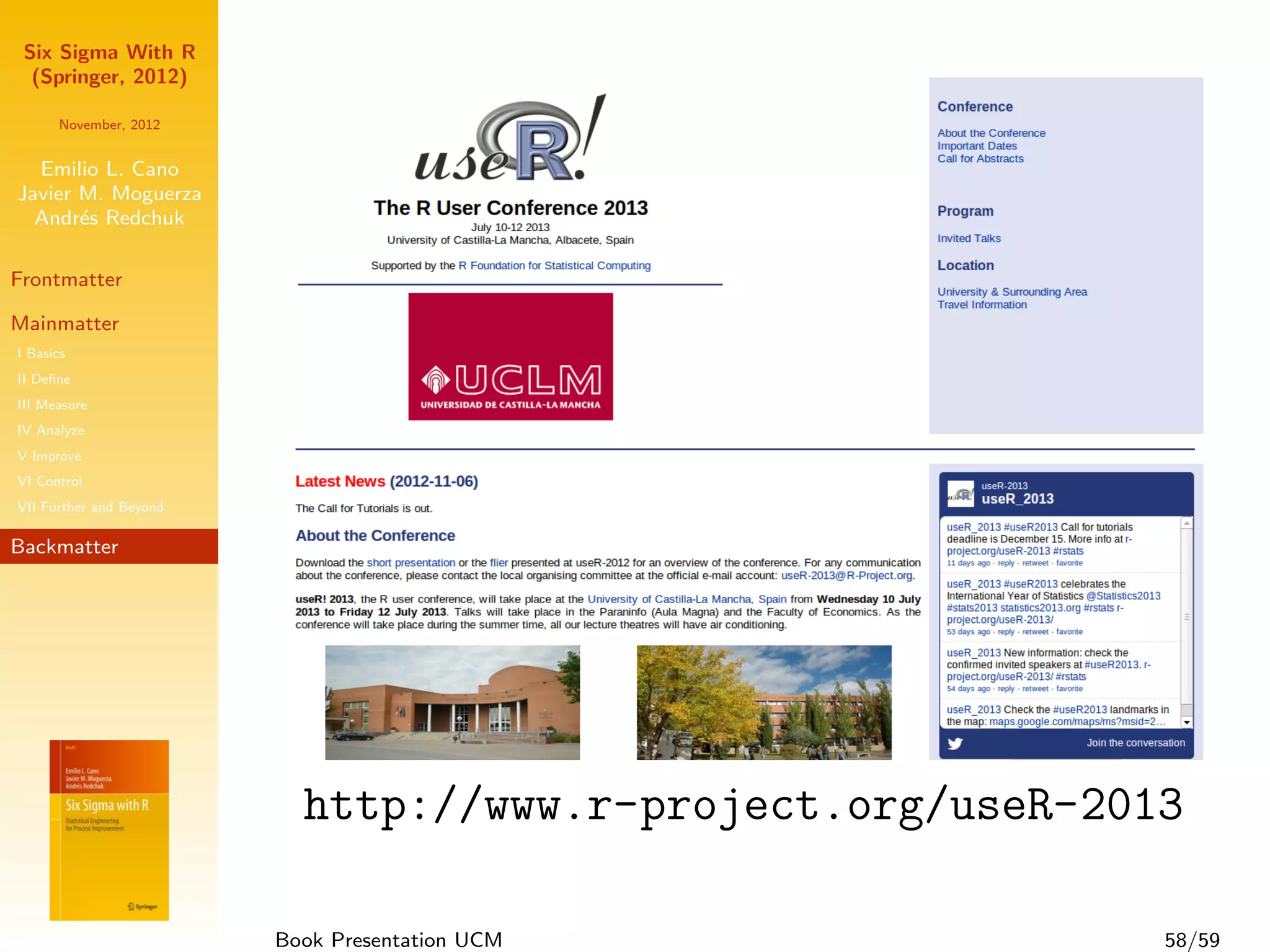

                           http://www.r-project.org/useR-2013

                         Book Presentation UCM              58/59
Six Sigma With R
  (Springer, 2012)       Discussion
      November, 2012

  Emilio L. Cano
Javier M. Moguerza
  Andr´s Redchuk
       e

                                                 Thanks !
Frontmatter

Mainmatter
I Basics
II Define
III Measure
IV Analyze
V Improve
VI Control
VII Further and Beyond

Backmatter                                       emilio.lopez@urjc.es
                                                   @emilopezcano

                                  http://www.sixsigmawithr.com

                         Book Presentation UCM                          59/59

More Related Content

What's hot

Transformaciones guiadas por hipotesis y experimentos
Transformaciones guiadas por hipotesis y experimentosTransformaciones guiadas por hipotesis y experimentos
Transformaciones guiadas por hipotesis y experimentos
John Araque

Product owner Roles and responsibilities in Agile Scrum Methodologies
Product owner Roles and responsibilities in Agile Scrum MethodologiesProduct owner Roles and responsibilities in Agile Scrum Methodologies
Product owner Roles and responsibilities in Agile Scrum Methodologies
Agile Project Management

Simplifying QA Process With Jira
Simplifying QA Process With JiraSimplifying QA Process With Jira
Simplifying QA Process With Jira
ICHOFU VICTOR

Sample project-Quality Circle
Sample project-Quality CircleSample project-Quality Circle
Sample project-Quality Circle
Mohamed Yusuff

Training - Introducing Agile, Lean and Kanban
Training - Introducing Agile, Lean and KanbanTraining - Introducing Agile, Lean and Kanban
Training - Introducing Agile, Lean and Kanban
Sudipta Lahiri

Scrum Plus Extreme Programming (XP) for Hyper Productivity
Scrum Plus Extreme Programming (XP) for Hyper ProductivityScrum Plus Extreme Programming (XP) for Hyper Productivity
Scrum Plus Extreme Programming (XP) for Hyper Productivity
Ron Quartel

Process Audit --VDA
Process Audit --VDAProcess Audit --VDA
Process Audit --VDA
Bill Yan

The Challenges of Agile Adoption
The Challenges of Agile AdoptionThe Challenges of Agile Adoption
The Challenges of Agile Adoption
Intelliware Development Inc.

Scrum retrospective
Scrum retrospective Scrum retrospective
Scrum retrospective
Priyanka Rana

Agile Scrum Presentation-Detailed
Agile Scrum Presentation-DetailedAgile Scrum Presentation-Detailed
Agile Scrum Presentation-Detailed
Prashaanth T R

Quality function deployment
Quality function deploymentQuality function deployment
Quality function deployment
RAJAGANAPATHY CHINNACHAMY

Introduction To Agile
Introduction To AgileIntroduction To Agile
Introduction To Agile
vineet

Lean And Six Sigma
Lean And Six SigmaLean And Six Sigma
Lean And Six Sigma
Yudha Satya Perdana

Scrum
ScrumScrum
Lean Six Sigma
Lean Six SigmaLean Six Sigma
Check in dance
Check in danceCheck in dance
Check in dance
Daniel Teng

Case Study of Agile Testing
Case Study of Agile TestingCase Study of Agile Testing
Case Study of Agile Testing
Naresh Jain

Advancing as a Scrum Master or Agile Coach
Advancing as a Scrum Master or Agile CoachAdvancing as a Scrum Master or Agile Coach
Advancing as a Scrum Master or Agile Coach
Rowan Bunning

Fundamentals of Agile Methodologies - Part I
Fundamentals of Agile Methodologies - Part IFundamentals of Agile Methodologies - Part I
Fundamentals of Agile Methodologies - Part I
Gopinath Ramakrishnan, Ph.D, CSM

Six sigma
Six sigmaSix sigma

What's hot (20)

Transformaciones guiadas por hipotesis y experimentos
Transformaciones guiadas por hipotesis y experimentosTransformaciones guiadas por hipotesis y experimentos
Transformaciones guiadas por hipotesis y experimentos

Product owner Roles and responsibilities in Agile Scrum Methodologies
Product owner Roles and responsibilities in Agile Scrum MethodologiesProduct owner Roles and responsibilities in Agile Scrum Methodologies
Product owner Roles and responsibilities in Agile Scrum Methodologies

Simplifying QA Process With Jira
Simplifying QA Process With JiraSimplifying QA Process With Jira
Simplifying QA Process With Jira

Sample project-Quality Circle
Sample project-Quality CircleSample project-Quality Circle
Sample project-Quality Circle

Training - Introducing Agile, Lean and Kanban
Training - Introducing Agile, Lean and KanbanTraining - Introducing Agile, Lean and Kanban
Training - Introducing Agile, Lean and Kanban

Scrum Plus Extreme Programming (XP) for Hyper Productivity
Scrum Plus Extreme Programming (XP) for Hyper ProductivityScrum Plus Extreme Programming (XP) for Hyper Productivity
Scrum Plus Extreme Programming (XP) for Hyper Productivity

Process Audit --VDA
Process Audit --VDAProcess Audit --VDA
Process Audit --VDA

The Challenges of Agile Adoption
The Challenges of Agile AdoptionThe Challenges of Agile Adoption
The Challenges of Agile Adoption

Scrum retrospective
Scrum retrospective Scrum retrospective
Scrum retrospective

Agile Scrum Presentation-Detailed
Agile Scrum Presentation-DetailedAgile Scrum Presentation-Detailed
Agile Scrum Presentation-Detailed

Quality function deployment
Quality function deploymentQuality function deployment
Quality function deployment

Introduction To Agile
Introduction To AgileIntroduction To Agile
Introduction To Agile

Lean And Six Sigma
Lean And Six SigmaLean And Six Sigma
Lean And Six Sigma

Scrum
ScrumScrum
Scrum

Lean Six Sigma
Lean Six SigmaLean Six Sigma
Lean Six Sigma

Check in dance
Check in danceCheck in dance
Check in dance

Case Study of Agile Testing
Case Study of Agile TestingCase Study of Agile Testing
Case Study of Agile Testing

Advancing as a Scrum Master or Agile Coach
Advancing as a Scrum Master or Agile CoachAdvancing as a Scrum Master or Agile Coach
Advancing as a Scrum Master or Agile Coach

Fundamentals of Agile Methodologies - Part I
Fundamentals of Agile Methodologies - Part IFundamentals of Agile Methodologies - Part I
Fundamentals of Agile Methodologies - Part I

Six sigma
Six sigmaSix sigma
Six sigma

Viewers also liked

Using R for Statistical Training: An Application to Six Sigma Methodology for...
Using R for Statistical Training: An Application to Six Sigma Methodology for...Using R for Statistical Training: An Application to Six Sigma Methodology for...
Using R for Statistical Training: An Application to Six Sigma Methodology for...
Emilio L. Cano

Six Sigma is Possible with R
Six Sigma is Possible with RSix Sigma is Possible with R
Six Sigma is Possible with R
Emilio L. Cano

Teaching Six Sigma Quality with R
Teaching Six Sigma Quality with RTeaching Six Sigma Quality with R
Teaching Six Sigma Quality with R
Emilio L. Cano

Six Sigma as a Quality Improvement Tool for Academic Programs
Six Sigma as a Quality Improvement Tool for Academic ProgramsSix Sigma as a Quality Improvement Tool for Academic Programs
Six Sigma as a Quality Improvement Tool for Academic Programs
Emilio L. Cano

Energy-efficient technology investments using a decision support system frame...
Energy-efficient technology investments using a decision support system frame...Energy-efficient technology investments using a decision support system frame...
Energy-efficient technology investments using a decision support system frame...
Emilio L. Cano

Statistical Methods for Quality
Statistical Methods for QualityStatistical Methods for Quality
Statistical Methods for Quality
Emilio L. Cano

Six Sigma
Six Sigma Six Sigma
Six Sigma
Phi Jack

Cutting costs, improving quality, & speeding delivery through continous impro...
Cutting costs, improving quality, & speeding delivery through continous impro...Cutting costs, improving quality, & speeding delivery through continous impro...
Cutting costs, improving quality, & speeding delivery through continous impro...
Eng Marzouk

Six Sigma Executive Overview
Six Sigma Executive OverviewSix Sigma Executive Overview
Six Sigma Executive Overview
DoctorKakish

01 overview of lean six sigma
01   overview of lean six sigma01   overview of lean six sigma
01 overview of lean six sigma
viragonline2002

Food Safety Risk Analysis - Part 1
Food Safety Risk Analysis - Part 1Food Safety Risk Analysis - Part 1
Food Safety Risk Analysis - Part 1
safefood360

Six Sigma Final
Six Sigma FinalSix Sigma Final
Six Sigma Final
anubhuti10

Six Sigma For Managers
Six Sigma For Managers   Six Sigma For Managers
Six Sigma For Managers
Yodhia Antariksa

Lean, Six Sigma, ToC using DMAIC project management
Lean, Six Sigma, ToC  using DMAIC project managementLean, Six Sigma, ToC  using DMAIC project management
Lean, Six Sigma, ToC using DMAIC project management
Simon Misiewicz

Calling Watson to Ward 8 Stat
Calling Watson to Ward 8 StatCalling Watson to Ward 8 Stat
Calling Watson to Ward 8 Stat
Nick van Terheyden

Digital health summit - Baylor Scott & White innovation panel
Digital health summit - Baylor Scott & White innovation panelDigital health summit - Baylor Scott & White innovation panel
Digital health summit - Baylor Scott & White innovation panel
Nick van Terheyden

GANG Announcements, Oct 2009
GANG Announcements, Oct 2009GANG Announcements, Oct 2009
GANG Announcements, Oct 2009
David Giard

Gang announcements 2011 07
Gang announcements 2011 07Gang announcements 2011 07
Gang announcements 2011 07
David Giard

Eol-Drupal Presentation for DrupalSouth 2008
Eol-Drupal Presentation for DrupalSouth  2008Eol-Drupal Presentation for DrupalSouth  2008
Eol-Drupal Presentation for DrupalSouth 2008
Dan Morrison

Viewers also liked (20)

Using R for Statistical Training: An Application to Six Sigma Methodology for...
Using R for Statistical Training: An Application to Six Sigma Methodology for...Using R for Statistical Training: An Application to Six Sigma Methodology for...
Using R for Statistical Training: An Application to Six Sigma Methodology for...

Six Sigma is Possible with R
Six Sigma is Possible with RSix Sigma is Possible with R
Six Sigma is Possible with R

Teaching Six Sigma Quality with R
Teaching Six Sigma Quality with RTeaching Six Sigma Quality with R
Teaching Six Sigma Quality with R

Six Sigma as a Quality Improvement Tool for Academic Programs
Six Sigma as a Quality Improvement Tool for Academic ProgramsSix Sigma as a Quality Improvement Tool for Academic Programs
Six Sigma as a Quality Improvement Tool for Academic Programs

Energy-efficient technology investments using a decision support system frame...
Energy-efficient technology investments using a decision support system frame...Energy-efficient technology investments using a decision support system frame...
Energy-efficient technology investments using a decision support system frame...

Statistical Methods for Quality
Statistical Methods for QualityStatistical Methods for Quality
Statistical Methods for Quality

Six Sigma
Six Sigma Six Sigma
Six Sigma

Cutting costs, improving quality, & speeding delivery through continous impro...
Cutting costs, improving quality, & speeding delivery through continous impro...Cutting costs, improving quality, & speeding delivery through continous impro...
Cutting costs, improving quality, & speeding delivery through continous impro...

Six Sigma Executive Overview
Six Sigma Executive OverviewSix Sigma Executive Overview
Six Sigma Executive Overview

01 overview of lean six sigma
01   overview of lean six sigma01   overview of lean six sigma
01 overview of lean six sigma

Food Safety Risk Analysis - Part 1
Food Safety Risk Analysis - Part 1Food Safety Risk Analysis - Part 1
Food Safety Risk Analysis - Part 1

Six Sigma Final
Six Sigma FinalSix Sigma Final
Six Sigma Final

Six Sigma For Managers
Six Sigma For Managers   Six Sigma For Managers
Six Sigma For Managers

Lean, Six Sigma, ToC using DMAIC project management
Lean, Six Sigma, ToC  using DMAIC project managementLean, Six Sigma, ToC  using DMAIC project management
Lean, Six Sigma, ToC using DMAIC project management

Calling Watson to Ward 8 Stat
Calling Watson to Ward 8 StatCalling Watson to Ward 8 Stat
Calling Watson to Ward 8 Stat

Forze
ForzeForze
Forze

Digital health summit - Baylor Scott & White innovation panel
Digital health summit - Baylor Scott & White innovation panelDigital health summit - Baylor Scott & White innovation panel
Digital health summit - Baylor Scott & White innovation panel

GANG Announcements, Oct 2009
GANG Announcements, Oct 2009GANG Announcements, Oct 2009
GANG Announcements, Oct 2009

Gang announcements 2011 07
Gang announcements 2011 07Gang announcements 2011 07
Gang announcements 2011 07

Eol-Drupal Presentation for DrupalSouth 2008
Eol-Drupal Presentation for DrupalSouth  2008Eol-Drupal Presentation for DrupalSouth  2008
Eol-Drupal Presentation for DrupalSouth 2008

More from Emilio L. Cano

R and Shiny to support real estate appraisers: An expert algorithm implementa...
R and Shiny to support real estate appraisers: An expert algorithm implementa...R and Shiny to support real estate appraisers: An expert algorithm implementa...
R and Shiny to support real estate appraisers: An expert algorithm implementa...
Emilio L. Cano

Generación de materiales didácticos multiformato con bookdown
Generación de materiales didácticos multiformato con bookdownGeneración de materiales didácticos multiformato con bookdown
Generación de materiales didácticos multiformato con bookdown
Emilio L. Cano

Unattended SVM parameters fitting for monitoring nonlinear profiles
Unattended SVM parameters fitting for monitoring nonlinear profilesUnattended SVM parameters fitting for monitoring nonlinear profiles
Unattended SVM parameters fitting for monitoring nonlinear profiles
Emilio L. Cano

Appling Scrum to Organize University Degrees Coursework
Appling Scrum to Organize University Degrees CourseworkAppling Scrum to Organize University Degrees Coursework
Appling Scrum to Organize University Degrees Coursework
Emilio L. Cano

Monitoring nonlinear profiles with {R}: an application to quality control
Monitoring nonlinear profiles with {R}: an application to quality controlMonitoring nonlinear profiles with {R}: an application to quality control
Monitoring nonlinear profiles with {R}: an application to quality control
Emilio L. Cano

Generación y corrección automática de trabajos evaluables personalizados con ...
Generación y corrección automática de trabajos evaluables personalizados con ...Generación y corrección automática de trabajos evaluables personalizados con ...
Generación y corrección automática de trabajos evaluables personalizados con ...
Emilio L. Cano

Talentyon: how to turn R expertise into business within the collaborative eco...
Talentyon: how to turn R expertise into business within the collaborative eco...Talentyon: how to turn R expertise into business within the collaborative eco...
Talentyon: how to turn R expertise into business within the collaborative eco...
Emilio L. Cano

Las normas ISO como puerta de entrada de la Estadística en la empresa
Las normas ISO como puerta de entrada de la Estadística en la empresaLas normas ISO como puerta de entrada de la Estadística en la empresa
Las normas ISO como puerta de entrada de la Estadística en la empresa
Emilio L. Cano

Las 7 herramientas básicas de la calidad con R
Las 7 herramientas básicas de la calidad con RLas 7 herramientas básicas de la calidad con R
Las 7 herramientas básicas de la calidad con R
Emilio L. Cano

Stochastic optimization and risk management for an efficient planning of buil...
Stochastic optimization and risk management for an efficient planning of buil...Stochastic optimization and risk management for an efficient planning of buil...
Stochastic optimization and risk management for an efficient planning of buil...
Emilio L. Cano

Análisis de inversiones energéticas en el ámbito del edificio
Análisis de inversiones energéticas en el ámbito del edificioAnálisis de inversiones energéticas en el ámbito del edificio
Análisis de inversiones energéticas en el ámbito del edificio
Emilio L. Cano

Standardisation on Statistics: ISO Standards and R Tools
Standardisation on Statistics: ISO Standards and R ToolsStandardisation on Statistics: ISO Standards and R Tools
Standardisation on Statistics: ISO Standards and R Tools
Emilio L. Cano

An integrated Solver Manager: using R and Python for energy systems optimization
An integrated Solver Manager: using R and Python for energy systems optimizationAn integrated Solver Manager: using R and Python for energy systems optimization
An integrated Solver Manager: using R and Python for energy systems optimization
Emilio L. Cano

Calidad Seis Sigma con R: Aplicación a la docencia
Calidad Seis Sigma con R: Aplicación a la docenciaCalidad Seis Sigma con R: Aplicación a la docencia
Calidad Seis Sigma con R: Aplicación a la docencia
Emilio L. Cano

Strategic Energy Systems Planning under Uncertainty
Strategic Energy Systems Planning under UncertaintyStrategic Energy Systems Planning under Uncertainty
Strategic Energy Systems Planning under Uncertainty
Emilio L. Cano

Reproducible Operations Research. An Application to Energy Systems Optimization
Reproducible Operations Research. An Application to Energy Systems OptimizationReproducible Operations Research. An Application to Energy Systems Optimization
Reproducible Operations Research. An Application to Energy Systems Optimization
Emilio L. Cano

A Solver Manager for energy systems planning within a Stochastic Optimization...
A Solver Manager for energy systems planning within a Stochastic Optimization...A Solver Manager for energy systems planning within a Stochastic Optimization...
A Solver Manager for energy systems planning within a Stochastic Optimization...
Emilio L. Cano

Strategic Buildings’ Energy Systems Planning
Strategic Buildings’ Energy Systems PlanningStrategic Buildings’ Energy Systems Planning
Strategic Buildings’ Energy Systems Planning
Emilio L. Cano

A Symbolic Model Specification for Energy Efficiency Optimization Models
A Symbolic Model Specification for Energy Efficiency Optimization ModelsA Symbolic Model Specification for Energy Efficiency Optimization Models
A Symbolic Model Specification for Energy Efficiency Optimization Models
Emilio L. Cano

Decision Making under Uncertainty: R implementation for Energy Efficient Buil...
Decision Making under Uncertainty: R implementation for Energy Efficient Buil...Decision Making under Uncertainty: R implementation for Energy Efficient Buil...
Decision Making under Uncertainty: R implementation for Energy Efficient Buil...
Emilio L. Cano

More from Emilio L. Cano (20)

R and Shiny to support real estate appraisers: An expert algorithm implementa...
R and Shiny to support real estate appraisers: An expert algorithm implementa...R and Shiny to support real estate appraisers: An expert algorithm implementa...
R and Shiny to support real estate appraisers: An expert algorithm implementa...

Generación de materiales didácticos multiformato con bookdown
Generación de materiales didácticos multiformato con bookdownGeneración de materiales didácticos multiformato con bookdown
Generación de materiales didácticos multiformato con bookdown

Unattended SVM parameters fitting for monitoring nonlinear profiles
Unattended SVM parameters fitting for monitoring nonlinear profilesUnattended SVM parameters fitting for monitoring nonlinear profiles
Unattended SVM parameters fitting for monitoring nonlinear profiles

Appling Scrum to Organize University Degrees Coursework
Appling Scrum to Organize University Degrees CourseworkAppling Scrum to Organize University Degrees Coursework
Appling Scrum to Organize University Degrees Coursework

Monitoring nonlinear profiles with {R}: an application to quality control
Monitoring nonlinear profiles with {R}: an application to quality controlMonitoring nonlinear profiles with {R}: an application to quality control
Monitoring nonlinear profiles with {R}: an application to quality control

Generación y corrección automática de trabajos evaluables personalizados con ...
Generación y corrección automática de trabajos evaluables personalizados con ...Generación y corrección automática de trabajos evaluables personalizados con ...
Generación y corrección automática de trabajos evaluables personalizados con ...

Talentyon: how to turn R expertise into business within the collaborative eco...
Talentyon: how to turn R expertise into business within the collaborative eco...Talentyon: how to turn R expertise into business within the collaborative eco...
Talentyon: how to turn R expertise into business within the collaborative eco...

Las normas ISO como puerta de entrada de la Estadística en la empresa
Las normas ISO como puerta de entrada de la Estadística en la empresaLas normas ISO como puerta de entrada de la Estadística en la empresa
Las normas ISO como puerta de entrada de la Estadística en la empresa

Las 7 herramientas básicas de la calidad con R
Las 7 herramientas básicas de la calidad con RLas 7 herramientas básicas de la calidad con R
Las 7 herramientas básicas de la calidad con R

Stochastic optimization and risk management for an efficient planning of buil...
Stochastic optimization and risk management for an efficient planning of buil...Stochastic optimization and risk management for an efficient planning of buil...
Stochastic optimization and risk management for an efficient planning of buil...

Análisis de inversiones energéticas en el ámbito del edificio
Análisis de inversiones energéticas en el ámbito del edificioAnálisis de inversiones energéticas en el ámbito del edificio
Análisis de inversiones energéticas en el ámbito del edificio

Standardisation on Statistics: ISO Standards and R Tools
Standardisation on Statistics: ISO Standards and R ToolsStandardisation on Statistics: ISO Standards and R Tools
Standardisation on Statistics: ISO Standards and R Tools

An integrated Solver Manager: using R and Python for energy systems optimization
An integrated Solver Manager: using R and Python for energy systems optimizationAn integrated Solver Manager: using R and Python for energy systems optimization
An integrated Solver Manager: using R and Python for energy systems optimization

Calidad Seis Sigma con R: Aplicación a la docencia
Calidad Seis Sigma con R: Aplicación a la docenciaCalidad Seis Sigma con R: Aplicación a la docencia
Calidad Seis Sigma con R: Aplicación a la docencia

Strategic Energy Systems Planning under Uncertainty
Strategic Energy Systems Planning under UncertaintyStrategic Energy Systems Planning under Uncertainty
Strategic Energy Systems Planning under Uncertainty

Reproducible Operations Research. An Application to Energy Systems Optimization
Reproducible Operations Research. An Application to Energy Systems OptimizationReproducible Operations Research. An Application to Energy Systems Optimization
Reproducible Operations Research. An Application to Energy Systems Optimization

A Solver Manager for energy systems planning within a Stochastic Optimization...
A Solver Manager for energy systems planning within a Stochastic Optimization...A Solver Manager for energy systems planning within a Stochastic Optimization...
A Solver Manager for energy systems planning within a Stochastic Optimization...

Strategic Buildings’ Energy Systems Planning
Strategic Buildings’ Energy Systems PlanningStrategic Buildings’ Energy Systems Planning
Strategic Buildings’ Energy Systems Planning

A Symbolic Model Specification for Energy Efficiency Optimization Models
A Symbolic Model Specification for Energy Efficiency Optimization ModelsA Symbolic Model Specification for Energy Efficiency Optimization Models
A Symbolic Model Specification for Energy Efficiency Optimization Models

Decision Making under Uncertainty: R implementation for Energy Efficient Buil...
Decision Making under Uncertainty: R implementation for Energy Efficient Buil...Decision Making under Uncertainty: R implementation for Energy Efficient Buil...
Decision Making under Uncertainty: R implementation for Energy Efficient Buil...

Recently uploaded

View Inheritance in Odoo 17 - Odoo 17 Slides
View Inheritance in Odoo 17 - Odoo 17  SlidesView Inheritance in Odoo 17 - Odoo 17  Slides
View Inheritance in Odoo 17 - Odoo 17 Slides
Celine George

FIRST AID PRESENTATION ON INDUSTRIAL SAFETY by dr lal.ppt
FIRST AID PRESENTATION ON INDUSTRIAL SAFETY by dr lal.pptFIRST AID PRESENTATION ON INDUSTRIAL SAFETY by dr lal.ppt
FIRST AID PRESENTATION ON INDUSTRIAL SAFETY by dr lal.ppt
ashutoshklal29

slidesgo-mastering-the-art-of-listening-insights-from-robin-sharma-2024070718...
slidesgo-mastering-the-art-of-listening-insights-from-robin-sharma-2024070718...slidesgo-mastering-the-art-of-listening-insights-from-robin-sharma-2024070718...
slidesgo-mastering-the-art-of-listening-insights-from-robin-sharma-2024070718...
MANIVALANSR

2 Post harvest Physiology of Horticulture produce.pptx
2 Post harvest Physiology of Horticulture  produce.pptx2 Post harvest Physiology of Horticulture  produce.pptx
2 Post harvest Physiology of Horticulture produce.pptx
UmeshTimilsina1

Introduction to Google Productivity Tools for Office and Personal Use
Introduction to Google Productivity Tools for Office and Personal UseIntroduction to Google Productivity Tools for Office and Personal Use
Introduction to Google Productivity Tools for Office and Personal Use
Excellence Foundation for South Sudan

BÀI TẬP BỔ TRỢ 4 KỸ NĂNG TIẾNG ANH LỚP 12 - GLOBAL SUCCESS - FORM MỚI 2025 - ...
BÀI TẬP BỔ TRỢ 4 KỸ NĂNG TIẾNG ANH LỚP 12 - GLOBAL SUCCESS - FORM MỚI 2025 - ...BÀI TẬP BỔ TRỢ 4 KỸ NĂNG TIẾNG ANH LỚP 12 - GLOBAL SUCCESS - FORM MỚI 2025 - ...
BÀI TẬP BỔ TRỢ 4 KỸ NĂNG TIẾNG ANH LỚP 12 - GLOBAL SUCCESS - FORM MỚI 2025 - ...
Nguyen Thanh Tu Collection

Node JS Interview Question PDF By ScholarHat
Node JS Interview Question PDF By ScholarHatNode JS Interview Question PDF By ScholarHat
Node JS Interview Question PDF By ScholarHat
Scholarhat

INSIDE OUT - PowerPoint Presentation.pptx
INSIDE OUT - PowerPoint Presentation.pptxINSIDE OUT - PowerPoint Presentation.pptx
INSIDE OUT - PowerPoint Presentation.pptx
RODELAZARES3

MATATAG CURRICULUM sample lesson exemplar.docx
MATATAG CURRICULUM sample lesson exemplar.docxMATATAG CURRICULUM sample lesson exemplar.docx
MATATAG CURRICULUM sample lesson exemplar.docx
yardenmendoza

Mail Server Configuration Using App passwords in Odoo 17
Mail Server Configuration Using App passwords in Odoo 17Mail Server Configuration Using App passwords in Odoo 17
Mail Server Configuration Using App passwords in Odoo 17
Celine George

1. Importance_of_reducing_postharvest_loss.pptx
1. Importance_of_reducing_postharvest_loss.pptx1. Importance_of_reducing_postharvest_loss.pptx
1. Importance_of_reducing_postharvest_loss.pptx
UmeshTimilsina1

C# Interview Questions PDF By ScholarHat.pdf
C# Interview Questions PDF By ScholarHat.pdfC# Interview Questions PDF By ScholarHat.pdf
C# Interview Questions PDF By ScholarHat.pdf
Scholarhat

MathematicsGrade7-Presentation-July-12024.pptx
MathematicsGrade7-Presentation-July-12024.pptxMathematicsGrade7-Presentation-July-12024.pptx
MathematicsGrade7-Presentation-July-12024.pptx
nolicaliso1

How To Sell Hamster Kombat Coin In Pre-market
How To Sell Hamster Kombat Coin In Pre-marketHow To Sell Hamster Kombat Coin In Pre-market
How To Sell Hamster Kombat Coin In Pre-market
Sikandar Ali

Open Source and AI - ByWater Closing Keynote Presentation.pdf
Open Source and AI - ByWater Closing Keynote Presentation.pdfOpen Source and AI - ByWater Closing Keynote Presentation.pdf
Open Source and AI - ByWater Closing Keynote Presentation.pdf
Jessica Zairo

React Interview Question PDF By ScholarHat
React Interview Question PDF By ScholarHatReact Interview Question PDF By ScholarHat
React Interview Question PDF By ScholarHat
Scholarhat

Brigada Eskwela 2024 PowerPoint Update for SY 2024-2025
Brigada Eskwela 2024 PowerPoint Update for SY 2024-2025Brigada Eskwela 2024 PowerPoint Update for SY 2024-2025
Brigada Eskwela 2024 PowerPoint Update for SY 2024-2025
ALBERTHISOLER1

5. Postharvest deterioration of fruits and vegetables.pptx
5. Postharvest deterioration of fruits and vegetables.pptx5. Postharvest deterioration of fruits and vegetables.pptx
5. Postharvest deterioration of fruits and vegetables.pptx
UmeshTimilsina1

PRESS RELEASE - UNIVERSITY OF GHANA, JULY 16, 2024.pdf
PRESS RELEASE - UNIVERSITY OF GHANA, JULY 16, 2024.pdfPRESS RELEASE - UNIVERSITY OF GHANA, JULY 16, 2024.pdf
PRESS RELEASE - UNIVERSITY OF GHANA, JULY 16, 2024.pdf
nservice241

E-learning Odoo 17 New features - Odoo 17 Slides
E-learning Odoo 17  New features - Odoo 17 SlidesE-learning Odoo 17  New features - Odoo 17 Slides
E-learning Odoo 17 New features - Odoo 17 Slides
Celine George

Recently uploaded (20)

View Inheritance in Odoo 17 - Odoo 17 Slides
View Inheritance in Odoo 17 - Odoo 17  SlidesView Inheritance in Odoo 17 - Odoo 17  Slides
View Inheritance in Odoo 17 - Odoo 17 Slides

FIRST AID PRESENTATION ON INDUSTRIAL SAFETY by dr lal.ppt
FIRST AID PRESENTATION ON INDUSTRIAL SAFETY by dr lal.pptFIRST AID PRESENTATION ON INDUSTRIAL SAFETY by dr lal.ppt
FIRST AID PRESENTATION ON INDUSTRIAL SAFETY by dr lal.ppt

slidesgo-mastering-the-art-of-listening-insights-from-robin-sharma-2024070718...
slidesgo-mastering-the-art-of-listening-insights-from-robin-sharma-2024070718...slidesgo-mastering-the-art-of-listening-insights-from-robin-sharma-2024070718...
slidesgo-mastering-the-art-of-listening-insights-from-robin-sharma-2024070718...

2 Post harvest Physiology of Horticulture produce.pptx
2 Post harvest Physiology of Horticulture  produce.pptx2 Post harvest Physiology of Horticulture  produce.pptx
2 Post harvest Physiology of Horticulture produce.pptx

Introduction to Google Productivity Tools for Office and Personal Use
Introduction to Google Productivity Tools for Office and Personal UseIntroduction to Google Productivity Tools for Office and Personal Use
Introduction to Google Productivity Tools for Office and Personal Use

BÀI TẬP BỔ TRỢ 4 KỸ NĂNG TIẾNG ANH LỚP 12 - GLOBAL SUCCESS - FORM MỚI 2025 - ...
BÀI TẬP BỔ TRỢ 4 KỸ NĂNG TIẾNG ANH LỚP 12 - GLOBAL SUCCESS - FORM MỚI 2025 - ...BÀI TẬP BỔ TRỢ 4 KỸ NĂNG TIẾNG ANH LỚP 12 - GLOBAL SUCCESS - FORM MỚI 2025 - ...
BÀI TẬP BỔ TRỢ 4 KỸ NĂNG TIẾNG ANH LỚP 12 - GLOBAL SUCCESS - FORM MỚI 2025 - ...

Node JS Interview Question PDF By ScholarHat
Node JS Interview Question PDF By ScholarHatNode JS Interview Question PDF By ScholarHat
Node JS Interview Question PDF By ScholarHat

INSIDE OUT - PowerPoint Presentation.pptx
INSIDE OUT - PowerPoint Presentation.pptxINSIDE OUT - PowerPoint Presentation.pptx
INSIDE OUT - PowerPoint Presentation.pptx

MATATAG CURRICULUM sample lesson exemplar.docx
MATATAG CURRICULUM sample lesson exemplar.docxMATATAG CURRICULUM sample lesson exemplar.docx
MATATAG CURRICULUM sample lesson exemplar.docx

Mail Server Configuration Using App passwords in Odoo 17
Mail Server Configuration Using App passwords in Odoo 17Mail Server Configuration Using App passwords in Odoo 17
Mail Server Configuration Using App passwords in Odoo 17

1. Importance_of_reducing_postharvest_loss.pptx
1. Importance_of_reducing_postharvest_loss.pptx1. Importance_of_reducing_postharvest_loss.pptx
1. Importance_of_reducing_postharvest_loss.pptx

C# Interview Questions PDF By ScholarHat.pdf
C# Interview Questions PDF By ScholarHat.pdfC# Interview Questions PDF By ScholarHat.pdf
C# Interview Questions PDF By ScholarHat.pdf

MathematicsGrade7-Presentation-July-12024.pptx
MathematicsGrade7-Presentation-July-12024.pptxMathematicsGrade7-Presentation-July-12024.pptx
MathematicsGrade7-Presentation-July-12024.pptx

How To Sell Hamster Kombat Coin In Pre-market
How To Sell Hamster Kombat Coin In Pre-marketHow To Sell Hamster Kombat Coin In Pre-market
How To Sell Hamster Kombat Coin In Pre-market

Open Source and AI - ByWater Closing Keynote Presentation.pdf
Open Source and AI - ByWater Closing Keynote Presentation.pdfOpen Source and AI - ByWater Closing Keynote Presentation.pdf
Open Source and AI - ByWater Closing Keynote Presentation.pdf

React Interview Question PDF By ScholarHat
React Interview Question PDF By ScholarHatReact Interview Question PDF By ScholarHat
React Interview Question PDF By ScholarHat

Brigada Eskwela 2024 PowerPoint Update for SY 2024-2025
Brigada Eskwela 2024 PowerPoint Update for SY 2024-2025Brigada Eskwela 2024 PowerPoint Update for SY 2024-2025
Brigada Eskwela 2024 PowerPoint Update for SY 2024-2025

5. Postharvest deterioration of fruits and vegetables.pptx
5. Postharvest deterioration of fruits and vegetables.pptx5. Postharvest deterioration of fruits and vegetables.pptx
5. Postharvest deterioration of fruits and vegetables.pptx

PRESS RELEASE - UNIVERSITY OF GHANA, JULY 16, 2024.pdf
PRESS RELEASE - UNIVERSITY OF GHANA, JULY 16, 2024.pdfPRESS RELEASE - UNIVERSITY OF GHANA, JULY 16, 2024.pdf
PRESS RELEASE - UNIVERSITY OF GHANA, JULY 16, 2024.pdf

E-learning Odoo 17 New features - Odoo 17 Slides
E-learning Odoo 17  New features - Odoo 17 SlidesE-learning Odoo 17  New features - Odoo 17 Slides
E-learning Odoo 17 New features - Odoo 17 Slides

Six Sigma with R

  • 1. Six Sigma With R (Springer, 2012) November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Six Sigma with R Frontmatter Statistical Engineering for Process Mainmatter Improvement I Basics II Define III Measure IV Analyze V Improve VI Control Emilio L. Cano, Javier M. Moguerza VII Further and Beyond Backmatter and Andr´s Redchuk e November 20, 2012 Facultad de Estudios Estad´ ısticos Universidad Complutense de Madrid Book Presentation UCM 1/59
  • 2. Six Sigma With R (Springer, 2012) Contenido November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e 1 Frontmatter Frontmatter Mainmatter 2 Mainmatter I Basics II Define I Basics III Measure IV Analyze V Improve II Define VI Control VII Further and Beyond III Measure Backmatter IV Analyze V Improve VI Control VII Further and Beyond 3 Backmatter Book Presentation UCM 2/59
  • 3. Six Sigma With R (Springer, 2012) Contents November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e 1 Frontmatter Frontmatter Mainmatter 2 Mainmatter I Basics II Define I Basics III Measure IV Analyze V Improve II Define VI Control VII Further and Beyond III Measure Backmatter IV Analyze V Improve VI Control VII Further and Beyond 3 Backmatter Book Presentation UCM 3/59
  • 4. Six Sigma With R (Springer, 2012) Publisher November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Mainmatter I Basics II Define III Measure IV Analyze V Improve VI Control VII Further and Beyond Backmatter http://www.springer.com/statistics/book/978-1-4614-3651-5 Book Presentation UCM 4/59
  • 5. Six Sigma With R (Springer, 2012) Book website November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Mainmatter I Basics II Define III Measure IV Analyze V Improve VI Control VII Further and Beyond Backmatter http://www.sixsigmawithr.com/ Book Presentation UCM 5/59
  • 6. Six Sigma With R (Springer, 2012) R Package November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Mainmatter I Basics II Define III Measure IV Analyze V Improve VI Control VII Further and Beyond Backmatter http://cran.r-project.org/web/packages/SixSigma/index.html Book Presentation UCM 6/59
  • 7. Six Sigma With R (Springer, 2012) Frontmatter November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Foreword Frontmatter Preface Mainmatter Why Six Sigma with R I Basics II Define Who is this book for III Measure Conventions IV Analyze V Improve Production VI Control VII Further and Beyond Resources Backmatter About the Authors Acknowledgements Contents List of Tables and Figures Acronyms http://link.springer.com/book/10.1007/978-1-4614-3652-2//page/1 Book Presentation UCM 7/59
  • 8. Six Sigma With R (Springer, 2012) Contents November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e 1 Frontmatter Frontmatter Mainmatter 2 Mainmatter I Basics II Define I Basics III Measure IV Analyze V Improve II Define VI Control VII Further and Beyond III Measure Backmatter IV Analyze V Improve VI Control VII Further and Beyond 3 Backmatter Book Presentation UCM 8/59
  • 9. Six Sigma With R (Springer, 2012) 1. Six Sigma in a Nutshell November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Herbert Spencer Mainmatter I Basics “Science is organised knowledge” II Define III Measure IV Analyze V Improve VI Control VII Further and Beyond Backmatter Book Presentation UCM 9/59
  • 10. Six Sigma With R (Springer, 2012) The DMAIC Cycle November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Mainmatter I Basics II Define III Measure IV Analyze V Improve VI Control VII Further and Beyond Backmatter Book Presentation UCM 10/59
  • 11. Six Sigma With R (Springer, 2012) Six Sigma Roles November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter In Six Sigma, everyone in the organization has Mainmatter I Basics a role in the project. Six Sigma methodology II Define III Measure IV Analyze uses an intuitive categorization of these roles. V Improve VI Control VII Further and Beyond Backmatter Book Presentation UCM 11/59
  • 12. Six Sigma With R (Springer, 2012) Six Sigma Roles November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter In Six Sigma, everyone in the organization has Mainmatter I Basics a role in the project. Six Sigma methodology II Define III Measure IV Analyze uses an intuitive categorization of these roles. V Improve VI Control VII Further and Beyond Backmatter Book Presentation UCM 11/59
  • 13. Six Sigma With R (Springer, 2012) 2. R from the Beginning November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Linus Torvalds Mainmatter I Basics “Software is like sex; it’s better when it’s free” II Define III Measure IV Analyze V Improve VI Control VII Further and Beyond Backmatter Book Presentation UCM 12/59
  • 14. Six Sigma With R (Springer, 2012) The R Project November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Mainmatter I Basics II Define III Measure IV Analyze V Improve VI Control VII Further and Beyond Backmatter http://www.r-project.org Book Presentation UCM 13/59
  • 15. Six Sigma With R (Springer, 2012) The R Environment November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Mainmatter I Basics II Define III Measure IV Analyze V Improve VI Control VII Further and Beyond Backmatter Book Presentation UCM 14/59
  • 16. Six Sigma With R (Springer, 2012) 3. Process Mapping with R November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Charles Franklin Kettering Mainmatter I Basics “A problem well stated is a problem half II Define III Measure solved” IV Analyze V Improve VI Control VII Further and Beyond Backmatter Book Presentation UCM 15/59
  • 17. Six Sigma With R (Springer, 2012) A Process Map November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Six Sigma Process Map Frontmatter operators INPUTS tools Mainmatter X raw material I Basics facilities II Define INSPECTION ASSEMBLY TEST LABELING III Measure sheets sheets helicopter helicopter IV Analyze ... INPUTS INPUTS INPUTS INPUTS V Improve VI Control VII Further and Beyond Param.(x): width NC Param.(x): operator C Param.(x): operator C Param.(x): operator C Backmatter operator C cut P throw P label P Measure pattern P fix P discard P Featur.(y): label discard P rotor.width C environment N Featur.(y): ok rotor.length C Featur.(y): time paperclip C tape C Featur.(y): weight LEGEND helicopter (C)ontrollable OUTPUTS (Cr)itical (N)oise Y (P)rocedure Paper Helicopter Project Book Presentation UCM 16/59
  • 18. Six Sigma With R (Springer, 2012) 4. Loss Funtion Analysis with R November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter W. Edwards Deming Mainmatter I Basics II Define Defects are not free. Somebody makes them, III Measure IV Analyze and gets paid for making them V Improve VI Control VII Further and Beyond Backmatter Book Presentation UCM 17/59
  • 19. Six Sigma With R (Springer, 2012) A Loss Function Example November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e > ss . lfa ( ss . data . bolts , " diameter " , 0.5 , 10 , 0.001 , lfa . sub = " 10 mm . Bolts Project " , Frontmatter lfa . size = 100000 , lfa . output = " both " ) Mainmatter I Basics II Define $ lfa . k III Measure [1] 0.002 IV Analyze V Improve VI Control $ lfa . lf VII Further and Beyond expression ( bold ( L == 0.002 %. % ( Y - 10) ^2) ) Backmatter $ lfa . MSD [1] 0.03372065 $ lfa . avLoss [1] 6.74413 e -05 $ lfa . Loss [1] 6.74413 Book Presentation UCM 18/59
  • 20. Six Sigma With R (Springer, 2012) A Loss Function Example (cont.) November, 2012 Emilio L. Cano Javier M. Moguerza Loss Function Analysis Andr´s Redchuk e Frontmatter 5e−04 T Data Mainmatter I Basics 4e−04 CTQ: diameter II Define Y0 = 10 III Measure Cost of Poor Quality ∆ = 0.5 IV Analyze L0 = 0.001 3e−04 V Improve Size = 1e+05 VI Control VII Further and Beyond 2e−04 Backmatter Mean = 10.0308 k = 0.002 1e−04 MSD = 0.0337 LSL USL Av.Loss = 1e−04 Loss = 6.7441 0e+00 9.6 9.8 10.0 10.2 10.4 Observed Value L = 0.002 ⋅ (Y − 10) 2 10 mm. Bolts Project Book Presentation UCM 19/59
  • 21. Six Sigma With R (Springer, 2012) 5. Measurement System Analysis November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Lord Kelvin Mainmatter “If you cannot measure it, I Basics II Define you cannot improve it.” III Measure IV Analyze V Improve VI Control VII Further and Beyond Backmatter Book Presentation UCM 20/59
  • 22. Six Sigma With R (Springer, 2012) Repeatability & Reproducibility November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Mainmatter I Basics Repetible and Reproducible Repetible but non Reproducible Reproducible but non Repetible Non Repetible & Non Reproducible II Define q q III Measure qq q q q q q q q IV Analyze q q V Improve q qq q qq VI Control VII Further and Beyond q q q q q Backmatter Book Presentation UCM 21/59
  • 23. Six Sigma With R (Springer, 2012) MSA with R November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Six Sigma Gage R&R Study Components of Variation Var by Part 1.8 Frontmatter 80 q q q q q 1.6 60 q q Percent Mainmatter 1.4 var 40 q q q q q q 1.2 I Basics 20 q q q q q 1.0 q 0 II Define G.R&R Repeat Reprod Part2Part q prot #1 prot #2 prot #3 III Measure %Contribution %Study Var IV Analyze R Chart by appraiser Var by appraiser prot #1 prot #2 prot #3 V Improve 1.8 q q q op #1 op #2 op #3 0.5 q q q q q VI Control 1.6 0.4 q q q VII Further and Beyond q 1.4 var 0.3 q var q q q q q q q q 0.2 1.2 q q q q q Backmatter 0.1 q q q 1.0 q q q q prot #1 prot #2 prot #3 prot #1 prot #2 prot #3 op #1 op #2 op #3 part x Chart by appraiser Part*appraiser Interaction prot #1 prot #2 prot #3 1.7 q op #1 op #2 op #3 1.7 q 1.6 q 1.6 q q 1.5 var 1.5 1.4 var 1.4 q 1.3 q q 1.3 q 1.2 1.2 q q q 1.1 q q 1.1 q q prot #1 prot #2 prot #3 prot #1 prot #2 prot #3 prot #1 prot #2 prot #3 op #1 op #3 part op #2 Helicopter Project Book Presentation UCM 22/59
  • 24. Six Sigma With R (Springer, 2012) 6. Pareto Analysis with R November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Ovidio Mainmatter I Basics Causa latet: vis est notissima. [The cause is II Define III Measure hidden, but the result is known.] IV Analyze V Improve VI Control VII Further and Beyond Backmatter Book Presentation UCM 23/59
  • 25. Six Sigma With R (Springer, 2012) Pareto Principle (80/20 rule) November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Mainmatter I Basics II Define Examples III Measure IV Analyze V Improve 20 % of customers make 80 % of incomes VI Control VII Further and Beyond 20 % of students get 80 % of good marks Backmatter 80 % of cost of quality is due to 20 % of the possible causes Book Presentation UCM 24/59
  • 26. Six Sigma With R (Springer, 2012) Cause-and-effect diagram November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Six Sigma Cause−and−effect Diagram Frontmatter Mainmatter I Basics Operator Environment Tools operator #1 height scissors II Define operator #2 cleaning tape III Measure operator #3 IV Analyze V Improve VI Control VII Further and Beyond Flight Time Backmatter paperclip model marks rotor.width2 calibrate thickness rotor.length Measure.Tool Raw.Material Design Paper Helicopter Project Book Presentation UCM 25/59
  • 27. Six Sigma With R (Springer, 2012) Pareto Chart November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Pareto Chart for b.vector q Frontmatter q q q q Mainmatter q 80% q 60 I Basics Cumulative Percentage q II Define q III Measure IV Analyze Frequency 40 V Improve q VI Control VII Further and Beyond Backmatter 20 q 0 Delays Materials Customer Training Rework Errors Rain Wind Permissions Inadequate Temperature Book Presentation UCM 26/59
  • 28. Six Sigma With R (Springer, 2012) 7. Process Capability Analysis November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Johann Wolfgang von Goethe Mainmatter One cannot develop taste from what is of I Basics II Define III Measure average quality but only from the very best. IV Analyze V Improve VI Control VII Further and Beyond Backmatter Book Presentation UCM 27/59
  • 29. Six Sigma With R (Springer, 2012) Capability Analysis Output November, 2012 Emilio L. Cano Javier M. Moguerza Six Sigma Capability Analysis Study Andr´s Redchuk e Histogram & Density Density Lines Legend Frontmatter Target Density ST Theoretical Dens. ST Mainmatter Density LT Theoretical Density LT I Basics II Define III Measure LSL USL Specifications IV Analyze LSL: 740 Target: 750 V Improve USL: 760 VI Control VII Further and Beyond Backmatter Short Term Process Long Term 740 745 750 755 760 Mean: 749.7625 Mean: 753.7239 Check Normality SD: 2.1042 SD: 2.6958 n: 20 n: 40 Shapiro−Wilk Test Zs: 3.14 Zs: 2.33 q p−value: 0.07506 DPMO: 9952.5 q Short Term Indices Long Term qq Lilliefors (K−S) Test Cp: 1.5841 Pp: 1.2365 qq qqq p−value: 0.2291 CI: [1.4,1.7] CI: [1.1,1.3] qq qqq qq qq Cpk: 1.5465 Ppk: 0.7760 q q CI: [1.4,1.7] CI: [0.7,0.8] Normality accepted when p−value > 0.05 Winery Project Book Presentation UCM 28/59
  • 30. Six Sigma With R (Springer, 2012) 8. Charts with R November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e John Tukey Frontmatter Mainmatter “The greatest value of a picture is when it I Basics II Define forces us to notice what we never expected to III Measure IV Analyze see.” V Improve VI Control VII Further and Beyond Backmatter Book Presentation UCM 29/59
  • 31. Six Sigma With R (Springer, 2012) Multi-vari chart November, 2012 Emilio L. Cano Multi−vari chart for Volume by color and operator Javier M. Moguerza Andr´s Redchuk e batch 1 q 2 q 3 q 4 q 1 2 3 Frontmatter 3 3 Mainmatter B C I Basics 18 II Define 17 III Measure 16 q q q q q q q q q IV Analyze 15 q q q q q q q q q q q q q q V Improve 14 VI Control 2 2 VII Further and Beyond B C q q 18 q Backmatter Volume q q 17 q q q q q q q 16 q q q q q q q q 15 q q q 14 1 1 B C q 18 q q q 17 q q q q q q 16 q q q q q q q 15 q q q q 14 q 1 2 3 Filler Book Presentation UCM 30/59
  • 32. Six Sigma With R (Springer, 2012) 9. Statistics and Probability with R November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Mainmatter Aaron Levenstein I Basics II Define “Statistics are like bikinis. What they reveal is III Measure IV Analyze V Improve suggestive, but what they conceal is vital.” VI Control VII Further and Beyond Backmatter Book Presentation UCM 31/59
  • 33. Six Sigma With R (Springer, 2012) Distributions November, 2012 Emilio L. Cano Hypergeometric Geometric Negative Binomial Poison Javier M. Moguerza Probability Probability Probability Probability 0.06 0.15 0.00 0.10 Andr´s Redchuk e 0.3 0.00 0.00 0.0 Frontmatter 0 1 2 3 4 0 10 30 10 20 30 40 0 5 10 20 Elements in class A Items extracted until first success Number of trials until 3 events Number of successful experiments per unit Mainmatter I Basics Exponential Lognormal Uniform Gamma Probability Density Probability Density Probability Density Probability Density II Define 0.0 0.4 0.8 0.0 0.6 1.2 0.0 0.2 0.4 III Measure 0.6 IV Analyze 0.0 V Improve 0 1 2 3 4 5 0 2 4 6 −0.5 0.5 1.5 0 2 4 6 8 VI Control Random Variable X Random Variable X>0 Random Variable X Random Variable X VII Further and Beyond Backmatter Beta Weibul t−Student Chi−squared Probability Density Probability Density Probability Density Probability Density 0.0 1.0 2.0 0.0 0.3 0.6 0.06 0.3 95% 5% 95% 5% 0.00 0.0 1.73 30.14 0.0 0.4 0.8 0 2 4 6 −4 0 2 4 10 30 50 Random Variable X Random Variable X Random Variable X Random Variable X F Probability Density 0.6 95% 5% 0.0 2.34 0 1 2 3 4 Random Variable X Book Presentation UCM 32/59
  • 34. Six Sigma With R (Springer, 2012) 10. Statistical Inference with R November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e George E.P. Box Frontmatter Mainmatter “All models are wrong; some models are I Basics II Define useful.” III Measure IV Analyze V Improve VI Control VII Further and Beyond Backmatter Book Presentation UCM 33/59
  • 35. Six Sigma With R (Springer, 2012) Confidence Interval Example November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Confidence Interval for the Mean Frontmatter Mean: 950.016 95% CI: [949.967, 950.064] Mainmatter StdDev: 0.267 P−Var: unknown I Basics n: 120 t: 1.98 II Define Missing: 0 III Measure IV Analyze V Improve VI Control Histogram & Density Plot Shapiro−Wilks 1.5 VII Further and Beyond Normality Test Backmatter 0.985 p−value: 0.19 1.0 density Normal q−q Plot 0.5 q qq q qq qq qq q qq q qq qq qq qq qq qq qq qq qq qq qq qq qq qq q q qq qq qq qq qq qq qq q 0.0 qq qq qqqq qq qq qq q qq qq qq qq q qq qq qq 949.0 949.5 950.0 950.5 q q q q Value of len q qq Book Presentation UCM 34/59
  • 36. Six Sigma With R (Springer, 2012) 11. Design of Experiments with R November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter R.A. Fisher Mainmatter “Sometimes the only thing you can I Basics II Define do with a poorly designed III Measure IV Analyze V Improve experiment is to try to find out what VI Control VII Further and Beyond it died of” Backmatter Book Presentation UCM 35/59
  • 37. Six Sigma With R (Springer, 2012) The Importance of Experimenting November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter “An engineer who does not know Mainmatter experimental design is not an I Basics II Define III Measure engineer” IV Analyze V Improve VI Control VII Further and Beyond Backmatter Comment made by to one of the authors [of “Statistics for experimenters” by an ] executive of the Toyota Motor Company. Book Presentation UCM 36/59
  • 38. Six Sigma With R (Springer, 2012) 12.Process Control with R November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Mainmatter Walter A. Shewhart I Basics II Define “Special causes of variation may be found and III Measure IV Analyze eliminated.” V Improve VI Control VII Further and Beyond Backmatter Book Presentation UCM 37/59
  • 39. Six Sigma With R (Springer, 2012) Control Chart Plotting November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e p Chart for stockouts 0.25 Frontmatter q q UCL Mainmatter q q 0.20 I Basics Group summary statistics II Define q III Measure 0.15 q q q q IV Analyze q V Improve q q VI Control 0.10 q q CL q VII Further and Beyond q q Backmatter q q 0.05 q q q q LCL 0.00 1 3 5 7 9 11 13 15 17 19 21 Group Number of groups = 22 Center = 0.1212294 LCL is variable Number beyond limits = 1 StdDev = 0.3263936 UCL is variable Number violating runs = 0 Book Presentation UCM 38/59
  • 40. Six Sigma With R (Springer, 2012) 13. Other Tools and November, 2012 Emilio L. Cano Javier M. Moguerza Methodologies Andr´s Redchuk e Frontmatter Mainmatter Johann Wolfgang von Goethe I Basics II Define Instruction does much, but encouragement III Measure IV Analyze V Improve everything. VI Control VII Further and Beyond Backmatter Book Presentation UCM 39/59
  • 41. Six Sigma With R (Springer, 2012) Other topics November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Mainmatter I Basics Failure Mode, Effects, and Criticality II Define III Measure Analysis IV Analyze V Improve VI Control Design for Six Sigma VII Further and Beyond Backmatter Lean Gantt Chart Some Advanced R Topics Book Presentation UCM 40/59
  • 42. Six Sigma With R (Springer, 2012) Contents November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e 1 Frontmatter Frontmatter Mainmatter 2 Mainmatter I Basics II Define I Basics III Measure IV Analyze V Improve II Define VI Control VII Further and Beyond III Measure Backmatter IV Analyze V Improve VI Control VII Further and Beyond 3 Backmatter Book Presentation UCM 41/59
  • 43. Six Sigma With R (Springer, 2012) Case Study November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Mainmatter I Basics II Define III Measure IV Analyze V Improve VI Control VII Further and Beyond Backmatter Book Presentation UCM 42/59
  • 44. Six Sigma With R (Springer, 2012) Helicopter Template November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Mainmatter I Basics II Define III Measure IV Analyze V Improve VI Control VII Further and Beyond Backmatter > ss . heli () null device 1 > # vignette (" H e l i c o p t e r I n s t r u c t i o n s ") to get instructions Book Presentation UCM 43/59
  • 45. Six Sigma with R | Paper Helicopter template max (9.5cm) std (8cm) min (6.5cm) ← wings length → cut ? pe fold ↑ fold ↓ ta cut cut cut ← body length → tape? tape? min (6.5cm) std fold ↓ ↓ fold ↑ ↑ (8cm) clip? max max min ← body width → min max (9.5cm) (6cm) (4cm) (4cm) (6cm)
  • 46. Six Sigma With R (Springer, 2012) Enjoy the Case Study! November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Mainmatter I Basics II Define III Measure IV Analyze V Improve VI Control VII Further and Beyond Backmatter Book Presentation UCM 45/59
  • 47. Six Sigma With R (Springer, 2012) Enjoy the Case Study! November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Mainmatter I Basics II Define III Measure IV Analyze V Improve VI Control VII Further and Beyond Backmatter Book Presentation UCM 45/59
  • 48. Six Sigma With R (Springer, 2012) So what? November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Mainmatter I Basics II Define III Measure IV Analyze V Improve VI Control VII Further and Beyond Backmatter Book Presentation UCM 46/59
  • 49. Six Sigma With R (Springer, 2012) So what? November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e The Scientific Method Frontmatter Mainmatter I Basics II Define III Measure IV Analyze V Improve VI Control VII Further and Beyond Backmatter Book Presentation UCM 46/59
  • 50. Six Sigma With R (Springer, 2012) The Scientific Method and Six November, 2012 Emilio L. Cano Javier M. Moguerza Sigma Andr´s Redchuk e Frontmatter Mainmatter DMAIC Cycle Scientific Method I Basics II Define Ask a question III Measure Define IV Analyze V Improve Do some background VI Control Measure research VII Further and Beyond Backmatter Construct a hypothesis Analyze Test the hypothesis with an experiment Improve Analyze the data and draw conclusions Control Communicate results Book Presentation UCM 47/59
  • 51. Six Sigma With R (Springer, 2012) The Key to Success November, 2012 Emilio L. Cano Javier M. Moguerza “Six Sigma speaks the language of business” Andr´s Redchuk e Frontmatter ISO 13053-1:2011 Mainmatter I Basics II Define III Measure IV Analyze Six Sigma methodology is a quality paradigm V Improve VI Control that translates the involved scientific VII Further and Beyond Backmatter methodology into a simple way to apply the scientific method within every organization. Book Presentation UCM 48/59
  • 52. Six Sigma With R (Springer, 2012) Opportunities November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter For Today’s Graduate, Just One Word: Statistics Mainmatter (The New York Times, August 2009) I Basics II Define “I keep saying that the sexy job in the III Measure IV Analyze next 10 years will be statisticians” V Improve VI Control VII Further and Beyond Backmatter Data Scientist: The Sexiest Job of the 21st Century (Harvard Business Review, October 2012) . . . the “data scientist.” It’s a high-ranking professional with the training and curiosity to make discoveries in the world of big data . . . Book Presentation UCM 49/59
  • 53. Six Sigma With R (Springer, 2012) Opportunities (cont.) November, 2012 Emilio L. Cano Gartner Sees 4.4M Big Data Jobs by 2015 Javier M. Moguerza Andr´s Redchuk e (Information Management, October 2012) Frontmatter Lack of data scientists could derail big data Mainmatter I Basics projects: IBM (CIO, October 2012) II Define III Measure IV Analyze Son las matem´ticas, est´pido (El Pa´ a u ıs, V Improve VI Control Noviembre 2012) VII Further and Beyond Backmatter La econom´ del conocimiento exige ıa una educaci´n sustentada en tres o fundamentos: un nivel avanzado en matem´tica y estad´ a ıstica, una capacidad elevada para escribir un argumento y un nivel avanzado de ingl´s e Book Presentation UCM 50/59
  • 54. Six Sigma With R (Springer, 2012) R Final Remarks November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Mainmatter I Basics II Define III Measure IV Analyze V Improve VI Control VII Further and Beyond kdnuggets.com Backmatter (2012) link Book Presentation UCM 51/59
  • 55. Six Sigma With R (Springer, 2012) R Final Remarks (cont.) November, 2012 Emilio L. Cano Javier M. Moguerza Community Andr´s Redchuk e 4131 packages at CRAN (18/11/2012) Frontmatter Mainmatter Task views I Basics II Define III Measure Manuals IV Analyze V Improve Publications VI Control VII Further and Beyond Backmatter http: //cran.r-project.org/web/packages/ Book Presentation UCM 52/59
  • 56. Six Sigma With R (Springer, 2012) R Final Remarks (cont.) November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Customization A company can develop a package that fits its Frontmatter Mainmatter inner procedures and methods. I Basics II Define III Measure IV Analyze V Improve Innovation VI Control VII Further and Beyond A company can develop and deploy an Backmatter innovative method from its R&D department, or from the result of other published researches. Book Presentation UCM 53/59
  • 57. Six Sigma With R (Springer, 2012) R Final Remarks (cont.) November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Business Mainmatter I Basics http: II Define III Measure //www.revolutionanalytics.com/ IV Analyze V Improve VI Control http://www.openanalytics.eu/ VII Further and Beyond Backmatter http://www.fellstat.com/ http://www.rstudio.com/ide/ http://www.datanalytics.com/ ... Book Presentation UCM 54/59
  • 58. Six Sigma With R (Springer, 2012) R Final Remarks (cont.) November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Mainmatter I Basics GUI, IDE II Define III Measure RStudio IV Analyze V Improve VI Control Eclipse + StatET VII Further and Beyond Backmatter EMACS + EES Deducer ... Book Presentation UCM 55/59
  • 59. Six Sigma With R (Springer, 2012) R Final Remarks (cont.) November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Mainmatter I Basics II Define III Measure IV Analyze V Improve VI Control VII Further and Beyond Backmatter Book Presentation UCM 56/59
  • 60. Six Sigma With R (Springer, 2012) November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Mainmatter I Basics II Define III Measure IV Analyze V Improve VI Control VII Further and Beyond Backmatter http://r-es.org/ Book Presentation UCM 57/59
  • 61. Six Sigma With R (Springer, 2012) November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Frontmatter Mainmatter I Basics II Define III Measure IV Analyze V Improve VI Control VII Further and Beyond Backmatter http://www.r-project.org/useR-2013 Book Presentation UCM 58/59
  • 62. Six Sigma With R (Springer, 2012) Discussion November, 2012 Emilio L. Cano Javier M. Moguerza Andr´s Redchuk e Thanks ! Frontmatter Mainmatter I Basics II Define III Measure IV Analyze V Improve VI Control VII Further and Beyond Backmatter emilio.lopez@urjc.es @emilopezcano http://www.sixsigmawithr.com Book Presentation UCM 59/59
