LEAN THINKING
                  with

                   Six Sigma
Cutting Costs, Improving Quality, &
          Speeding Delivery
                  By
  Continuous Process Improvement
Prepared By: Kurt E. Robertson
              Organization Consulting Department
              Saudi Aramco
              874-6204
The Robertson Guarantee

IF YOU KEEP ON DOING WHAT
   YOU HAVE ALWAYS DONE

YOU WILL KEEP ON GETTING
 WHAT YOU'VE ALWAYS GOT.
            I PROMISE
         LEAN THINKING with SIX SIGMA

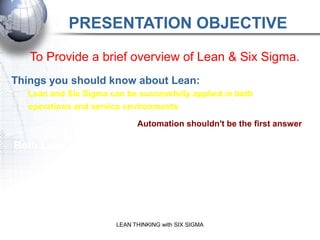

PRESENTATION OBJECTIVE

   To Provide a brief overview of Lean & Six Sigma.
Things you should know about Lean:
  Lean and Six Sigma can be successfully applied in both
  operations and service environments

                              Automation shouldn't be the first answer

Both Lean and Six Sigma are data driven

 Lean is Team-based           Lean takes a Systems Approach

                                  Lean is a:
               physical transformation to your processes
                         LEAN THINKING with SIX SIGMA
              transformation of your organization cultural

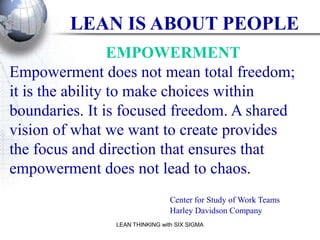

LEAN IS ABOUT PEOPLE
                  EMPOWERMENT
Empowerment does not mean total freedom;
it is the ability to make choices within
boundaries. It is focused freedom. A shared
vision of what we want to create provides
the focus and direction that ensures that
empowerment does not lead to chaos.
                                 Center for Study of Work Teams
                                 Harley Davidson Company
                LEAN THINKING with SIX SIGMA

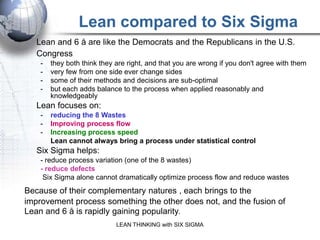

Lean compared to Six Sigma
     Lean and 6 å are like the Democrats and the Republicans in the U.S.
     Congress
       -   they both think they are right, and that you are wrong if you don't agree with them
       -   very few from one side ever change sides
       -   some of their methods and decisions are sub-optimal
       -   but each adds balance to the process when applied reasonably and
           knowledgeably
     Lean focuses on:
       -   reducing the 8 Wastes
       -   Improving process flow
       -   Increasing process speed
           Lean cannot always bring a process under statistical control
     Six Sigma helps:
       - reduce process variation (one of the 8 wastes)
       - reduce defects
        Six Sigma alone cannot dramatically optimize process flow and reduce wastes
 Because of their complementary natures , each brings to the
 improvement process something the other does not, and the fusion of
 Lean and 6 å is rapidly gaining popularity.
                               LEAN THINKING with SIX SIGMA
DO LEAN FIRST before SIX SIGMA 99% of the time
Complementary Tools
                           6 Sigma
                     OVERALL YIELD vs SIGMA
                        (Distribution Shifted ñ1.5 å )
      # of
     Steps
       1          93.32%        99.379%         99.9767%               99.99966%
       7          61.63         95.733           99.839                 99.9976
                                                       ion
      10          50.08          93.96           99.768                 99.9966
      20          25.08          88.29           99.536                 99.9932
      40
      60
                   6.29
                   1.58
                                 77.94
                                 68.81             riat
                                                 99.074
                                                 98.614
                                                                        99.9864
                                                                        99.9796
      80           0.40          60.75
                                               sv a
                                                 98.156                 99.9728
L                                           les
      100          0.10          53.64            97.70                  99.966
      150          ---           39.38            96.61                  99.949

                                   ps -
      200          ---           28.77            95.45                  99.932
E     300          ---           15.43            93.26                  99.898

                              rs te
      400          ---            8.28            91.11                  99.864
      500          ---            4.44            89.02                  99.830
A     600
      700
                   ---
                   ---      we
                                  2.38
                                  1.28
                                                  86.97
                                                  84.97
                                                                         99.796
                                                                         99.762
N     800          ---    fe      0.69            83.02                  99.729

                  s te-
      900          ---            0.37            81.11                  99.695
     1000          ---            0.20            79.24                  99.661
                wa
     1200          ---            0.06            75.88                  99.593
     3000          ---            ---             50.15                  98.985
     17000
            s      ---            ---               1.91                 94.384
         Les
     38000
     70000
                   ---            ---               0.01                 87.880
                                                                         78.820
    150000                                                               60.000

                                                           Source: SIX SIGMA RESEARCH INSTITUTE
                                                                      Motorola University Motorola, Inc.

                   LEAN THINKING with SIX SIGMA
Combining Lean and Six Sigma
Lean reduces cost, improves quality, and speeds delivery by
eliminating non-value added activity in a process by identifying
and eliminating waste .
 Six Sigma is a more data-driven approach which aims to
reduce cost, improve quality, and speed delivery by
process variability and defects using the five-step DMAIC
reducing
model. 6 å depends heavily on data mining and data integrity.
 Lean Six Sigma: Any combination should maintain the
integrity of each discipline while combining the benefits of
each. Attempting to make one look like a part of the other
Sub-optimizes both . Problem complexity often determines
which to use. Don't use a hammer to crack a peanut shell .

                     LEAN THINKING with SIX SIGMA
When to use Lean or Six Sigma
Lean is an AXE . Use Lean if:
     This is the first and or second pass at identifying and eliminating
     waste
     Process problems include:
           flow
           operator cycle time
           product lead time
           delivery time
           quality
           costs
     You need rapid improvement
     You need a mile-wide, inch-deep approach
Six Sigma is a SCALPEL . Use Six Sigma if:
     Lean has made a first pass with improvement
     Defects and variation still persist and you need refined data analysis
     with an inch-wide, mile-deep approach

Lean is not about tinkering withSIX SIGMA existing processes.
                     LEAN THINKING with your

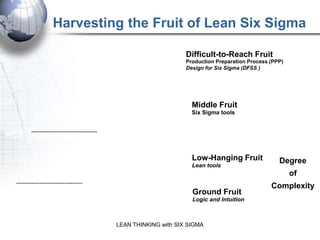

Harvesting the Fruit of Lean Six Sigma

                                                                  Difficult-to-Reach Fruit
                                                                  Production Preparation Process (PPP)
                                                                  Design for Six Sigma (DFSS )

                                                                    Middle Fruit
                                                                    Six Sigma tools

       ----------------------------------

                                                                    Low-Hanging Fruit               Degree
                                                                    Lean tools
                                                                                                         of
----------------------------------
                                                                                                 Complexity
                                                                    Ground Fruit
                                                                    Logic and Intuition

                                            LEAN THINKING with SIX SIGMA
Let's Talk Lean First
                   Do Lean First in most cases
  And you should

               LEAN THINKING with SIX SIGMA
AGENDA
History
Definition
Goal
Process
Value Stream Mapping
Kaizen
Becoming Lean
Lean and Quality
Metrics
Why Lean Fails
Six Sigma
Resistance
Six Sigma
Your Responsibility
How it ends LEAN THINKING with SIX SIGMA

Resources

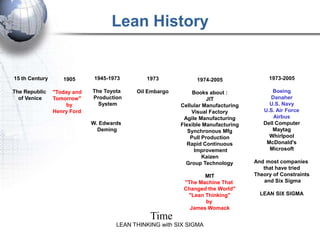

Lean History

15 th Century      1905       1945-1973       1973             1974-2005               1973-2005

The Republic    "Today and   The Toyota    Oil Embargo        Books about :              Boeing
  of Venice     Tomorrow"    Production                             JIT                Danaher
                     by        System                    Cellular Manufacturing        U.S. Navy
                Henry Ford                                   Visual Factory          U.S. Air Force
                                                          Agile Manufacturing            Airbus
                             W. Edwards                  Flexible Manufacturing      Dell Computer
                               Deming                       Synchronous Mfg             Maytag
                                                             Pull Production           Whirlpool
                                                           Rapid Continuous           McDonald's
                                                              Improvement              Microsoft
                                                                  Kaizen
                                                           Group Technology       And most companies
                                                                                     that have tried
                                                                 MIT              Theory of Constraints
                                                          "The Machine That          and Six Sigma
                                                          Changed the World"
                                                           "Lean Thinking"          LEAN SIX SIGMA
                                                                 by
                                                            James Womack
                                               Time
                                     LEAN THINKING with SIX SIGMA
AGENDA
History
Definition
Goal
Process
Value Stream Mapping
Kaizen
Becoming Lean
Lean and Quality
Metrics
Why Lean Fails
Resistance
Your Responsibility
How it ends
Resources

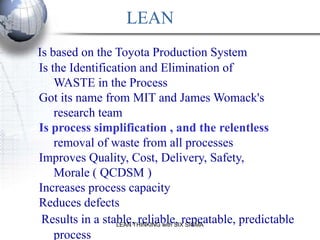

            LEAN THINKING with SIX SIGMA
LEAN
Is based on the Toyota Production System
Is the Identification and Elimination of
    WASTE in the Process
Got its name from MIT and James Womack's
    research team
Is process simplification , and the relentless
    removal of waste from all processes
Improves Quality, Cost, Delivery, Safety,
    Morale ( QCDSM )
Increases process capacity
Reduces defects
 Results in a stable,THINKING with SIXrepeatable, predictable
                 LEAN
                      reliable, SIGMA
    process
General Rules
1. Lean is about fixing the SYSTEM and transforming the
    CULTURE (CM).
2. Lean is about FLOW.
3. Lean is about people , not just about improvement tools.
4. Lean is about YOUR expectations and about what
    YOU are willing to tolerate in terms of Q uality, C ost,
    D elivery, S afety, and M orale (QCDSM) .
5. Processes rarely get better on their own.
6. Successful processes have rules , standards , &
    absolutes .
7. To solve a problem you have to admit you have one.
8. Problems need to be quantitatively defined and their
    corrective action quantitatively tracked.
    System) .
    (Measurement
9. Every project needs a Value Stream Champion.
                     LEAN THINKING with SIX SIGMA

The System

Planning     Material Supply Operations Sales and Marketing

               Value Stream

              Value Stream

           LEAN THINKING with SIX SIGMA
WASTE

           Waste is any activity that:
           1. The customer isn't willing
           to pay for.

2. Doesn't positively change the
form, fit, or function of the product
or service (Value Added)
If it prevents the FLOW
of product or information..

    LEAN THINKING with SIX SIGMA

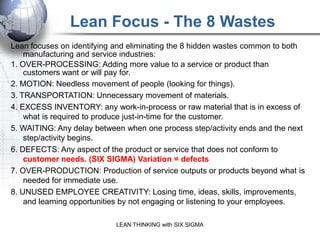

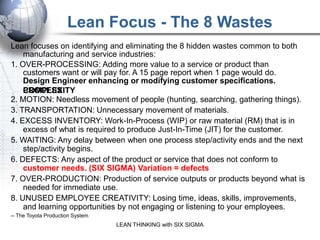

Lean Focus - The 8 Wastes
Lean focuses on identifying and eliminating the 8 hidden wastes common to both
    manufacturing and service industries:
1. OVER-PROCESSING: Adding more value to a service or product than
    customers want or will pay for. A 15 page report when 1 page would do.
    Design Engineer enhancing or modifying customer specifications.
    PROCESS
    COMPLEXITY
2. MOTION: Needless movement of people (hunting, searching, gathering things).
3. TRANSPORTATION: Unnecessary movement of materials.
4. EXCESS INVENTORY: Work-In-Process (WIP) or raw material (RM) that is in
    excess of what is required to produce Just-In-Time (JIT) for the customer.
5. WAITING: Any delay between when one process step/activity ends and the next
    step/activity begins.
6. DEFECTS: Any aspect of the product or service that does not conform to
    customer needs. (SIX SIGMA) Variation = defects
7. OVER-PRODUCTION: Production of service outputs or products beyond what is
    needed for immediate use.
8. UNUSED EMPLOYEE CREATIVITY: Losing time, ideas, skills, improvements,
    and learning opportunities by not engaging or listening to your employees.
-- The Toyota Production System
                                  LEAN THINKING with SIX SIGMA

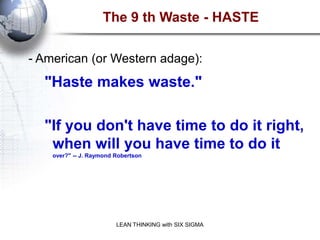

The 9 th Waste - HASTE

- American (or Western adage):
  "Haste makes waste."

  "If you don't have time to do it right,
   when will you have time to do it
    over?" -- J. Raymond Robertson

                         LEAN THINKING with SIX SIGMA
Understanding FLOW

 LEAN THINKING with SIX SIGMA

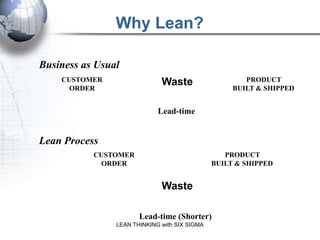

Why Lean?

Business as Usual
    CUSTOMER                  Waste                    PRODUCT
      ORDER                                         BUILT & SHIPPED

                             Lead-time

Lean Process
           CUSTOMER                               PRODUCT
             ORDER                             BUILT & SHIPPED

                              Waste

                       Lead-time (Shorter)
                LEAN THINKING with SIX SIGMA

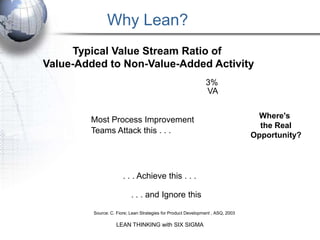

Why Lean?
     Typical Value Stream Ratio of
Value-Added to Non-Value-Added Activity
                                                               3%
                       97% NVA                                 VA

                                                                                  Where's
        Most Process Improvement
                                                                                   the Real
        Teams Attack this . . .
                                                                                 Opportunity?
                       97% NVA

                       . . . Achieve this . . .

                           . . . and Ignore this

         Source: C. Fiore; Lean Strategies for Product Development , ASQ, 2003

                    LEAN THINKING with SIX SIGMA

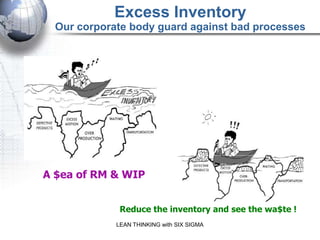

Excess Inventory
        Our corporate body guard against bad processes

      A $ea of RM & WIP

                    Reduce the inventory and see the wa$te !
                   LEAN THINKING with SIX SIGMA

You can `t be Lean unless your suppliers are Lean.

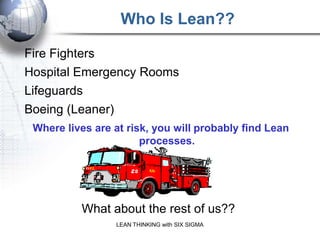

Who Is Lean??

Fire Fighters
Hospital Emergency Rooms
Lifeguards
Boeing (Leaner)
 Where lives are at risk, you will probably find Lean
                       processes.

          What about the rest of us??
                 LEAN THINKING with SIX SIGMA

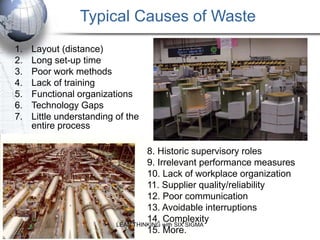

Typical Causes of Waste
1.   Layout (distance)
2.   Long set-up time
3.   Poor work methods
4.   Lack of training
5.   Functional organizations
6.   Technology Gaps
7.   Little understanding of the
     entire process

                                   8. Historic supervisory roles
                                   9. Irrelevant performance measures
                                   10. Lack of workplace organization
                                   11. Supplier quality/reliability
                                   12. Poor communication
                                   13. Avoidable interruptions
                                   14. Complexity
                          LEAN THINKING with SIX SIGMA
                                   15. More.
Non-Value-Adding Activities
                                 (Operations)

"Non-value-adding" activity (NVA) consumes time and
   money...but does not change the value of an item.

      1.   SORTING
      2.   COUNTING
      3.   STACKING
      4.   EXPEDITING
      5.   TRANSFERRING
      6.   CHECKING
      7.   TRANSPORTING
      8.   HUNTING, SEARCHING, GATHERING
                    LEAN THINKING with SIX SIGMA

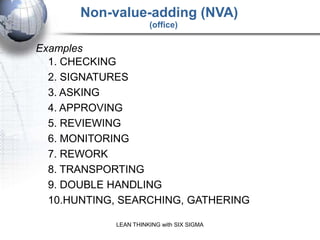

Non-value-adding (NVA)
                      (office)

Examples
  1. CHECKING
  2. SIGNATURES
  3. ASKING
  4. APPROVING
  5. REVIEWING
  6. MONITORING
  7. REWORK
  8. TRANSPORTING
  9. DOUBLE HANDLING
  10.HUNTING, SEARCHING, GATHERING

            LEAN THINKING with SIX SIGMA
The Goal of Lean
Improved product Q uality, C ost, D elivery; Improved
  employee S afety and M orale ( Q C D S M) in any
  operational or service process.
1. By establishing
     (one-piece) Flow
     Based in Takt Time
     In a Pull environment (JIT)
2. But first I need processes that are:
      Stable
      Reliable
      Predictable
      Repeatable
3. I get those processes by establishing:
       Awareness - at all levels of the organization
      5S - Workplace organization
      Value Stream Mapping - information and material flow
      Flow - improve plant or office layout
      Leveled Production - reduce lot sizes, setup time, lead times,
                     LEAN THINKING with SIX SIGMA
      inventory
Lean Kaizen Sequence

Processes can be transformed
                                          Distribution
in days, weeks or months,                System Kaizen
                                             One-piece flow
but plan 1- 6 years                           Pull/Kanban
                                               Takt time
for the corporate
                                 Equipment Kaizen (TPM)
transformation                   3P, Autonomation

                                      Leveled Production
                                       Line Balancing
                                  Reduce: lot sizes, setup times, lead times,
                                   operator cycle times, inventory
                                                                                AWA
                      FLOW:       AIWs (Gemba Kaizen)                           REN
                                  Factory Layout Kaizen
                      Standard Work: Operator Methods                           ESS
                                            process simplification,
                                            quality and maintenance

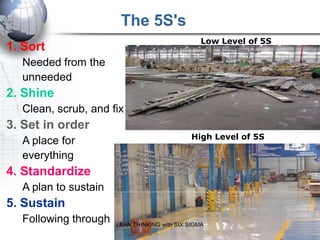

                                            - 5S -
                                     Organize the workplace
                                    LEAN THINKING with SIX SIGMA
The Lean Toolbox
1.    Value Stream Maps                    17. SIX SIGMA
2.    Rapid Improvement (Kaizen)           18. Chaku-Chaku / Load-Load
      Events                               19. Heijunka / Load Leveling
3.    Education                            20. Bottlenecks
4.    Employee Involvement                 21. Point-of-Use Delivery
5.    Metrics and Alignment                22. DFMA
6.    Flow Cells                           23. Control Charting
7.    Standard Work                        24. Pareto Analysis
      - Capacity Analysis                  25. Histograms
      - Takt Time / Cycle Time             26. Root Cause Analysis
          Standard Ops Worksheet           27. 5 Why's
      - Production Control Board
                                           28. Hypothesis Testing
8.    5S / Visual Controls                 29. Supply Chain Management
9.    Pull/Kanban Systems                  30. Critical Chain Project
10.   Brainstorming                             Management
11.   Prioritization                       31. 7 Quality Control Tools
12.   Spaghetti Chart                      32. 7 Management & Planning
13.   Poka-Yoke / Mistake Proofing              Tools
14.   Set-up Reduction                     33. Nominal Group Technique
15.   Total Productive Maintenance with SIX 34. Production Process
                           LEAN THINKING   SIGMA
16.   Change Management                         Preparation (3P)
How Do I Know Which Tool To Use?

How do you know whether to use Microsoft:
      -   Excel
      -   PowerPoint
      -   Word
      -   Access
      -   Project
      -   Visio
Excel is probably not the best choice for word processing.
Word is probably not the best choice for calculations.
**The KNOWLEDGEABLE, EXPERIENCED use of a tool
       is the key to the SUCCESSFUL use of a tool**

                       LEAN THINKING with SIX SIGMA
AGENDA
History
Definition
 Goal
 Process
Value Stream Mapping
Kaizen
Becoming Lean
Lean and Quality
Metrics
Why Lean Fails
Resistance
Six Sigma
Your Responsibility
How it ends
Resources LEAN THINKING with SIX SIGMA

Team Charter
                                                        Dates:
    VSM
                            Impact
    RIE                                                 Senior Management Sponsor:
    Project
                                                        Value Stream Champion:
    Just Do It                        Difficulty

Project Description:
                                                        Team Leaders and Members:

                                                        Potential Implementation Costs:

Business Reason for the Project:
                                                        Project Constraints
                                                        (Financial, Personnel, Equipment):

                                                        Expected ROI:

                                     LEAN THINKING with SIX SIGMA

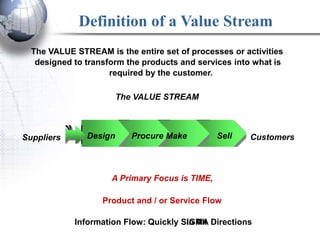

Definition of a Value Stream
  The VALUE STREAM is the entire set of processes or activities
   designed to transform the products and services into what is
                     required by the customer.

                        The VALUE STREAM

Suppliers      Design      Procure Make         Sell   Customers

                     A Primary Focus is TIME,

                   Product and / or Service Flow

            Information Flow: Quickly SIGMA Directions
                                       In All

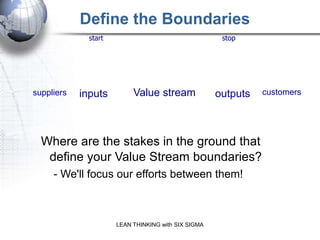

Define the Boundaries
              start                                   stop

                         What keeps you awake
                               at night?

suppliers   inputs         Value stream              outputs   customers

  Where are the stakes in the ground that
   define your Value Stream boundaries?
     - We'll focus our efforts between them!

                      LEAN THINKING with SIX SIGMA

Value $tream Map - Finding the
               WA$TE      Production Control
                                                                                                 90/60/30 day
                                   6 week                                                        forecasts
         SUPPLIER                  forecast                                                                                CUSTOMER
                                                          MRP                                               Daily
                                   Weekly
                                                                                                            Order
         500 ft coils              Fax                                                                                 18400 pieces/month
                                                                                                     Daily Ship        -12000- L
                                                          Weekly Schedule                            Schedule           - 6400- R
               Tues. &
                                                                                                                         Tray = 20 pieces
               Thurs.                                                                                                       2 shifts

                                                                                   Ass'y                  Ass'y
              Stampin                S. Weld               S. Weld
                                                                                    #1                     #2                        Shipping
              g                      #1                    #2
  I                          I                     I                      I                      I                     I
                      1                     1                   1                     1                      1                        Staging
Coils                     4600 L                 1100 L              1600 L                    1200 L                 2700 L
5 days                    2400 R                  600R                   850R                   640R                  1440R
             C/T=1 sec              C/T=39 sec            C/T=46 sec            C/T=62 sec              C/T=40 sec
            C/O=1 hour              C/O=10 m              C/O=10 m               C/O = 0                 C/O = 0      .0014% VA
            Uptime =                Uptime =              Uptime =              Uptime =                Uptime =
               85%                    100%                   80%                  100%                    100%
             27,600 *2               27,600 *2             27,600 *2             27,600 *2              27,600 *2
             sec. avail.             sec. avail.           sec. avail.           sec. avail.            sec. avail.
5 days                      7.6d                   1.8d                  2.7d                    2d                   4.5d      PLT = 23.6 days
              1 sec                    39 sec               46 sec                 62 sec                  40 sec               Process Time
                                                                                                                               (VAT) = 188 sec.
                                                LEAN THINKING with SIX SIGMA
Current State
Value Stream Map
                                                                                                                                 Current State - March '02
AREA:         Harrier Maintenance Flight (500 Hour Minor)
             BUSINESS CASE:                          VALUE STATEMENT:                           KEY REQUIREMENTS:                       MEASUREMENTS:            IDEAL STATE:
Improve Harrier Maintenance Flight   Identify, remove and repair failed, broken, or Core Manpower Requirements      Productivity (hours per unit)       ON DEMAND

Operating Performance                obsolete parts for Harrier W eapon Platform, Operational Risk                  Throughput Time                     DEFECT FREE
                                     functional test, and reapply finish
                                                                                  Quality and Flight Safety         On Time Delivery                    1 BY 1

                                                                                  Cost of other Platforms           Floor Space                         LOW EST COST

                                                                      LEAN THINKING with SIX SIGMA
          Future State                                                                                                   Implementation Pan

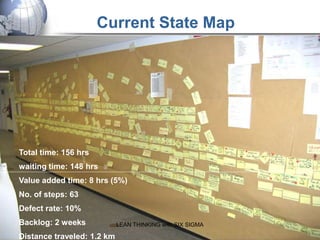

Current State Map

Total time: 156 hrs
waiting time: 148 hrs
Value added time: 8 hrs (5%)
No. of steps: 63
Defect rate: 10%
Backlog: 2 weeks            LEAN THINKING with SIX SIGMA

Distance traveled: 1.2 km

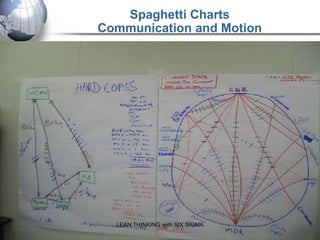

Spaghetti Charts
Communication and Motion

  LEAN THINKING with SIX SIGMA
IN CHARGE OF FOLLOWUP:                                                  Project Name
                                                                                     Status of overall completion =   % 28

                                                    Plan Dates
                   ACTION      Who                                                      Comments                      %Status
                                            Start            Finish

PROJECT SUMMARY:

                            In charge                     C COMPL
                                    of
        Action Department          this
                                          BEGIN                  ET
                                                                 E
                                                                                    Comments                            40
                                  item

                              ASD /       7/3/200          7/10/200   AAD to AJD:Follow-up this action item and
1                                                                                                                      100
                                MZU             7                 7        report completion

                            AJD /
                                                                      AAD to AJD: Make sure this is done
                                    ASD   7/3/200         8/10/200
2                                                                          MAS: You can decide where the                5
                                    /           7               7
                                                                           location of the hotline be.
                                    MZU

                              ASD /       7/3/200          8/10/200
3                                                                                                                      100
                                MZU             7                 7

                            LEAN THINKING with SIX SIGMA
LEAN AGENDA

History
Definition
Goal
Process
Value Stream Mapping
Kaizen
Becoming Lean
Lean and Quality
Metrics
Why Lean Fails
Resistance
Six Sigma
Your Responsibility
How it ends
Resources LEAN THINKING with SIX SIGMA
Kaizen = continuous improvement

RAPID IMPROVEMENT
At the end of the week, a new process should be in place.
Anything else is not rapid improvement. It's a "STUDY".

                    LEAN THINKING with SIX SIGMA
Team Charter
                                                        Dates:
    VSM
                            Impact
    RIE                                                 Senior Management Sponsor:
    Project
                                                        Value Stream Champion:
    Just Do It                        Difficulty

Project Description:
                                                        Team Leaders and Members:

                                                        Potential Implementation Costs:

Business Reason for the Project:
                                                        Project Constraints
                                                        (Financial, Personnel, Equipment):

                                                        Expected ROI:

                                     LEAN THINKING with SIX SIGMA

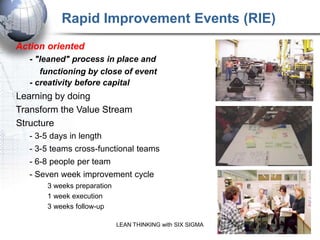

Rapid Improvement Events (RIE)
Action oriented
   - "leaned" process in place and
      functioning by close of event
   - creativity before capital
Learning by doing
Transform the Value Stream
Structure
   - 3-5 days in length
   - 3-5 teams cross-functional teams
   - 6-8 people per team
   - Seven week improvement cycle
       3 weeks preparation
       1 week execution
       3 weeks follow-up

                             LEAN THINKING with SIX SIGMA
RIE Preparation Checklist
Rapid Improvement Events

 By:                         Date:                             Prep. % COT:
                                                                                                                  PREPARATION
  Team:

3rd Week Before Event:                  (% COT:    ) 2nd Week Before Event:                     (% COT:     ) 1st Week Before Event:                     (% COT:    )

                                                         1) Identify the suppliers and inputs                      1) Communicate key metrics, targets, and
    1) Select the Value Stream from the
                                                         2) Identify the customers and outputs                     tools to be applied to all team participants
    Enterprise
                                                         3) Identify the start / stop boundaries                   2) Train team participants on improvement
    Transformation Plan.
                                                         4) Gather facts and data to populate starting             process and tools to be applied
    2) Select the target area from Value Stream
                                                         numbers on Target Progress Report                         3) Identify what "triggers" work
    Analysis.
                                                         5) Populate the Target Progress Report                    4) Double check availability of all resources:
    3) Determine the focus - which Lean tools
                                                         6) Identify top three improvement metrics                 - equipment or furniture moves
    will be applied?
                                                         7) Establish improvement targets on top three             - computer or phone moves
    4) Identify the Team Leader, Co-Leader, and
                                                         metrics, be aggressive                                    - 5S, shadowing, kitting
    Team Members.
                                                         8) Meet with affected stakeholders to                     - Production Control Boards
    5) Assure at least 1/3rd of participants are
                                                         communicate Improvement Event schedule,                   5) Communicate with affected area, review
    from the affected area.
                                                         metrics, targets, and tools to be applied                 items listed on flip chart and ask for
    6) Clear participants calendars for the
                                                         9) Set a flip chart up in affected area, ask              clarification, make sure these are added to
    Improvement Event Week.
                                                         stakeholders to put ideas for improvement                 Improvement Newspaper
    7) Complete the Team Roster.
                                                         on flip chart. Start Improvement Newspaper.               6) Make sure team break-out area is ready:
                                                         10) Capture flow stopper information from                 - flip charts, markers, post-its, VSA blanks
                                                         Production Control Boards                                 - forms, stop watches
                                                         11) Confirm the availability of any special               7) Make sure Process Champion is set
                                                         resources for:                                            to give opening remarks on Monday
                                                         - equipment or furniture moves                            morning
                                                         - computer / phone moves                                  8) Make sure Process Champion is available
                                                         - 5S, shadowing, kitting                                  for Team Leader Meetings Monday -
                                                         - Production Control Boards                               Wednesday
                                                         12) Obtain any special data collection                    9) Schedule Final Presentation with Process
                                                         instructions from your Coach such as:                     Champion and appropriate leadership
                                                         - Information from previous Improvement                   10) Plan working lunches
                                                         Events                                                    11)Confirm all team participants are going to
                                                         - Customer critical to quality issues                     be available full time for entire event
                                                         - Safety data                                             12) Confirm Target Progress Report and
                                                         13) Confirm all participants are still available          Team Roster are complete
                                                         for entire Event week
                                                            LEAN THINKING with SIX SIGMA
RIE Daily Checklist
Rapid Improvement Events
                                                                                                                         TEAM DAILY CHECKLIST

Day One.                                                       Day Two.                                                 Day Three.                                                Day Four.
  1. Review team goals and objectives, create Day 1 plan.        1. Identify wastes to attack.                            1. Train Stakeholders on new cell layout and standard      1. Train Stakeholders on new cell layout and
                                                                                                                            work.                                                      standard work
  2. Meet with Cell Stakeholders and review goals.               2. After TAKT time/Cycle time bar charts.
                                                                   (loading diagram)                                      2. Assign a team member to each Stakeholder.               2. Assign a team member to each Stakeholder.
  3. Before Data, Documentation and "Tools"
     TAKT Time Calculation                                       3. Create plan for new cell layout.                      3. Run new cell.                                           3. Run new cell.
     Before Time Observations
     Before Cycle Time Bar Charts (Loading Diagrams)             4. Meet with Stakeholders, review progress and plans     4. Fix problems immediately.                               4. Create/post Key Point, Work Combination Sheets,
     Before Standard Work Sheet/Cell Layout                        solicit ideas and concerns.                                                                                          Standard Work Sheet, Production Control Board,
     Before WIP Count ($ and pieces)                                                                                      5. Create production control board.                           and Kaizen Newspaper.
     Before 6S Audit                                             5. After standard work combination sheets.
     Before Safety Audit                                                                                                  6. Work on 6-S and safety issues.                          5. Fix problems immediately.
     Before Work Combination Sheets (one per operator)           6. Notify support groups by 2.00 PM of required
                                                                   support.                                               7. Create/post Key Point, Work Combination Sheets,         6. After 6-S and safety audits.
  4. Take a "Waste Walk", to further identify opportunities.                                                                 Standard Work Sheet, Production Control Board,
                                                                 7. Daily recap.                                             and Kaizen Newspaper.                                   7. Off shop floor by 1:00.
  5. Daily recap.
                                                                 8. Create daily plan for Wednesday.                      8. Daily recap.                                            8. After area pictures and Team picture.
  6. Meet with Stakeholders and review progress.ideas.
                                                                 9. Team Leader/Co Leader. How late do we stay?           9. Create daily plan for Thursday.                         9. Prepare final presentation.
  7. Create daily plan for Tuesday.
                                                                 10. Daily Team Leader meeting.                           10. Team Leader/Co Leader. How late do we stay?            10. Complete Team/Event binder.
  8. Team Leader/Co-Leader. How late do we stay?
                                                                 11. 6-S meeting area.                                    11. Daily Team Leader meeting.                             11. 6-S meeting area.
  9. Daily Team Leader meeting.
                                                                 12. Implement plan/create cell.                          12. 6-S meeting area.                                      12. Inventory kit boxes and find missing articles.
  10. 6-S meeting area.

  ** Team Leaders need to assign action items                    ** Team Leaders need to assign action items             ** Team Leaders need to assign action items                 ** Team Leaders need to assign action items
  to specific people on the teams and require                    to specific people on the teams and require             to specific people on the teams and require                 to specific people on the teams and require
                                                                                                                        with SIXup reports on progress at a minimum
                                                                                                                         follow increments.
  follow up reports on progress at a minimum
  of two hour increments.
                                                                 follow up reports on LEAN
                                                                                     progress at a minimum
                                                                 of two hour increments.                                 of two hour
                                                                                                                                             SIGMA                                   follow up reports on progress at a minimum
                                                                                                                                                                                     of two hour increments.
                                                                 THINKING
LEAN AGENDA

History
Definition
Goal
Process
Value Stream Mapping
Kaizen
Becoming Lean
Lean and Quality
Metrics
Why Lean Fails
Resistance
Six Sigma
Your Responsibility
How it ends
Resources LEAN THINKING with SIX SIGMA
The 5S Principles:
  Proper arrangement and orderliness

"Good factories (workplaces) develop beginning
with the 5Ss; bad factories fall apart beginning with
the 5Ss."                   -Hiroyuki Hirano
5S Workplace Organization
1. SORT (seiri): Clearly distinguish what is necessary & what is not. Remove
   what does not support an organized, visual and Lean workplace.
2. SIMPLIFY (seiton): Ensure everything required to do the task has a visually
   designated location, is available, functional, and can easily be seen, reached
   and returned in the sequence used; Consider an operating room or fire
   engine. Mark/label locations clearly.
3. SWEEP (seiso): Keep the work area, tools and equipment - Floors,
   machines, desks, files, equipment - organized, organized, repaired (TPM),
   and visually marked.
4. STANDARDIZE (seiketsu): Maintain & improve the first 3S's. Establish
   procedures so storage and cleaning actions are consistently applied by
   everyone.
5. SUSTAIN (shitsuke): Hold the gains. Achieve the discipline/habit of
   following the correct procedures. From this new level of efficiency, start
   again.

                            LEAN THINKING with SIX SIGMA

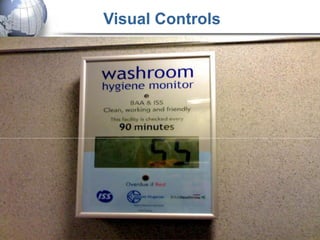

Visual Controls
                      A Major Element of 5S
Visual controls:
  - Answer a question before it is asked
  - Help spot abnormalities in the system
  - Examples:
      Medical - Moment of Truth
      KSA/Bahrain Causeway booth lights:
         - Avg and Std Dev

                         LEAN THINKING with SIX SIGMA
The 5S's
                                                 Low Level of 5S
1. Sort
  Needed from the
  unneeded
2. Shine
  Clean, scrub, and fix
3. Set in order
                                              High Level of 5S
  A place for
  everything
4. Standardize
  A plan to sustain
5. Sustain
  Following through   LEAN THINKING with SIX SIGMA

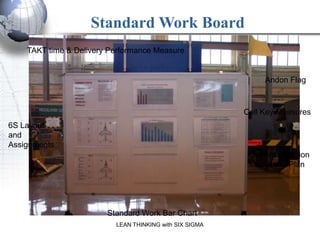

Standard Work Board
    TAKT time & Delivery Performance Measure

                                                              Andon Flag

                                                         Cell Key Measures
6S Layout
and
Assignments
                                                          Corrective Action
                                                          Matrix and Plan

                        Standard Work Bar Chart
                          LEAN THINKING with SIX SIGMA
LEAN THINKING with SIX SIGMA
Shadow Hand Tools

  LEAN THINKING with SIX SIGMA
Signal Lights

  LEAN THINKING with SIX SIGMA

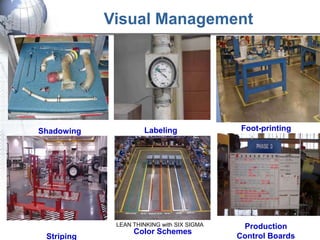

Visual Management

Shadowing            Labeling                Foot-printing

             LEAN THINKING with SIX SIGMA    Production
                  Color Schemes
 Striping                                   Control Boards
LEAN THINKING with SIX SIGMA
Visual Controls

 LEAN THINKING with SIX SIGMA
Other Visual & Audio Controls
              Visual and Audio controls answer questions before they are asked.
1.    Clock
2.    Traffic lights with a timer
3.    Traffic Lines/ lights/signs
4.    Sounds announcing break time
5.    Call to Prayer
6.    Score boards at sporting events
7.    Arrival/Departure boards in airports
8.    Lights indicating machine or process condition
9.    Lights and siren on emergency vehicles
10.   Gauges on medical & industrial equipment
11.   Big teeth on a snarling lion
12.   Take-a-Number systems
13.   Colored caps on milk bottles
                           LEAN THINKING with SIX SIGMA

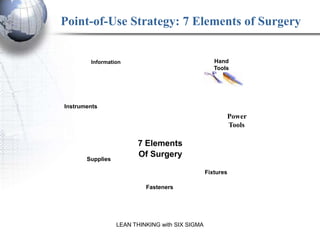

Point-of-Use Strategy: 7 Elements of Surgery

        Information                                 Hand
                                                    Tools

Instruments
                                                        Power
                                                        Tools

                        7 Elements
       Supplies
                        Of Surgery

                                                 Fixtures

                           Fasteners

                  LEAN THINKING with SIX SIGMA

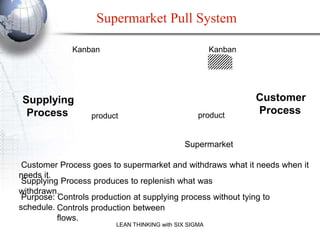

Supermarket Pull System

             Kanban                                    Kanban

Supplying                                                       Customer
 Process          product                         product
                                                                Process

                                             Supermarket

 Customer Process goes to supermarket and withdraws what it needs when it
needs it.
 Supplying Process produces to replenish what was
withdrawn.
 Purpose: Controls production at supplying process without tying to
schedule. Controls production between
          flows.
                        LEAN THINKING with SIX SIGMA

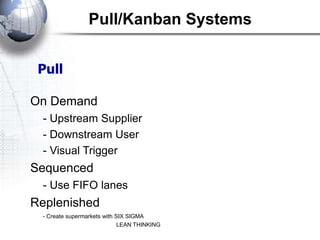

Pull/Kanban Systems

 Pull

On Demand
  - Upstream Supplier
  - Downstream User
  - Visual Trigger
Sequenced
  - Use FIFO lanes
Replenished
  - Create supermarkets with SIX SIGMA
                              LEAN THINKING
Traditional vs Cellular Flow

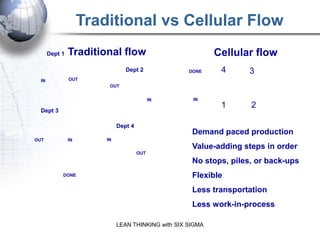

       Dept 1   Traditional flow                             Cellular flow
                                 Dept 2              DONE     4      3
  IN            OUT
                          OUT

                                             IN       IN
                                                              1      2
  Dept 3

                              Dept 4
                                                      Demand paced production
OUT             IN       IN
                                                      Value-adding steps in order
                                       OUT
                                                      No stops, piles, or back-ups
            DONE                                      Flexible
                                                      Less transportation
                                                      Less work-in-process

                              LEAN THINKING with SIX SIGMA
U - Shaped Cell

Andon

                                       RM

                                       FG

        LEAN THINKING with SIX SIGMA

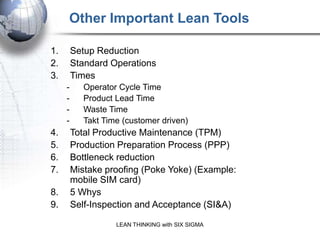

Other Important Lean Tools

1.       Setup Reduction
2.       Standard Operations
3.       Times
     -      Operator Cycle Time
     -      Product Lead Time
     -      Waste Time
     -      Takt Time (customer driven)
4.       Total Productive Maintenance (TPM)
5.       Production Preparation Process (PPP)
6.       Bottleneck reduction
7.       Mistake proofing (Poke Yoke) (Example:
         mobile SIM card)
8.       5 Whys
9.       Self-Inspection and Acceptance (SI&A)

                    LEAN THINKING with SIX SIGMA
Lean Implementation Sequence

                           Distribution
                          System Kaizen
                             One-piece flow
                              Pull/Kanban
                               Takt time

PEO               Equipment Kaizen (TPM)
                  3P, Autonomation
PLE
                       Leveled Production
                        Line Balancing
                   Reduce: lot sizes, setup times, lead times,
                    operator cycle times, inventory
                                                                 AWA
       FLOW:       AIWs (Gemba Kaizen)                           REN
                   Factory Layout Kaizen
       Standard Work: Operator Methods                           ESS
                             process simplification,
                             quality and maintenance

                             - 5S -
                      Organize the workplace
                     LEAN THINKING with SIX SIGMA
LEAN AGENDA

History
Definition
Goal
Process
Value Stream Mapping
 Kaizen
 Becoming Lean
Lean and Quality
Metrics
Why Lean Fails
Resistance
Six Sigma
Your Responsibility
How it ends
Resources LEAN THINKING with SIX SIGMA

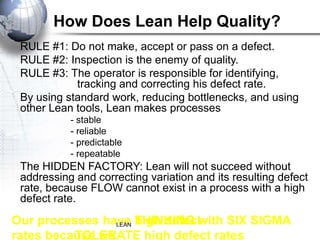

How Does Lean Help Quality?
 RULE #1: Do not make, accept or pass on a defect.
 RULE #2: Inspection is the enemy of quality.
 RULE #3: The operator is responsible for identifying,
            tracking and correcting his defect rate.
 By using standard work, reducing bottlenecks, and using
 other Lean tools, Lean makes processes
           - stable
           - reliable
           - predictable
           - repeatable
 The HIDDEN FACTORY: Lean will not succeed without
 addressing and correcting variation and its resulting defect
 rate, because FLOW cannot exist in a process with a high
 defect rate.

Our processes have THINKING with SIX SIGMA
                 LEAN high defect

          TOLERATE high defect rates
rates because we
AGENDA
History
Definition
Goal
Process
Value Stream Mapping
 Kaizen
 Becoming Lean
 Lean and Quality
Metrics
Why Lean Fails
Resistance
Six Sigma
Your Responsibility
How it ends
Resources LEAN THINKING with SIX SIGMA

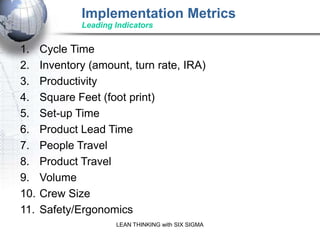

Implementation Metrics
              Leading Indicators

1.    Cycle Time
2.    Inventory (amount, turn rate, IRA)
3.    Productivity
4.    Square Feet (foot print)
5.    Set-up Time
6.    Product Lead Time
                                 Lean is data driven
7.    People Travel
8.    Product Travel
9.    Volume
10.   Crew Size
11.   Safety/Ergonomics
                      LEAN THINKING with SIX SIGMA
METRICS - The Forensics of CPI

1. What gets measured gets fixed .
2. If you can measure it, you can change it.
3. Metrics drive behavior . Tell me how you will measure me and I will tell
    you how I will perform.
4. The folly of rewarding A while hoping for B .
5. Measure first, then manage.
6. Leading indicators versus Lagging indicators (NDE)- Always reviewing
    the past , and not guiding the future . Manage the leading indicators,
    and the lagging indicators will be O.K.
7. Problems must be quantified, exposed and confronted . Lean cannot
    remedy an unacknowledged or hidden problem.
8. Don't measure effort and process compliance. Measure results.
9. What you allow, you encourage.
10. Your Recommendations are only as good as your analysis. Your
    analysis is only as good as your data. Your data is only as good as you
    measurement system. Data Integrity is the foundation of a credible
    project.                  LEAN THINKING with SIX SIGMA
AGENDA
History
Definition
Goal
Process
Value Stream Mapping
 Kaizen
 Becoming Lean
 Lean and Quality
 Metrics
Why Lean Fails
Resistance
Six Sigma
Your Responsibility
How it ends
Resources LEAN THINKING with SIX SIGMA
Reasons Lean Fails
1. No sense of urgency (burning platform)
2. Looking for a quick fix (lean pill)
3. No leadership commitment and support
      Awareness
      Full-time practitioners
4. No education and awareness among the employees
    and management. (CM)
5. No understanding of Lean (flavor of the month)
6. No Sensei (Do-It-Yourself Lean)
7. No Value Stream Map
8. No implementation or sustaining plan (PM)
9. No customer and supplier involvement in the
    improvement process.
                       LEAN THINKING with SIX SIGMA
AGENDA
History
Definition
Goal
Process
Value Stream Mapping
 Kaizen
 Becoming Lean
 Lean and Quality
 Metrics
 Why Lean Fails
Resistance
Six Sigma
Your Responsibility
How it ends
Resources LEAN THINKING with SIX SIGMA

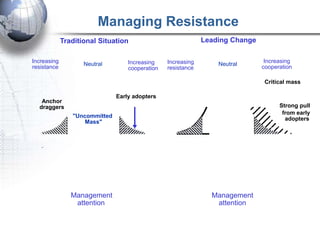

Managing Resistance
                     Traditional Situation                            Leading Change

        Increasing                         Increasing    Increasing                     Increasing
                            Neutral                                       Neutral
        resistance                         cooperation   resistance                    cooperation

                                                                                        Critical mass

                                       Early adopters
           Anchor
          draggers                                                                           Strong pull
                                                                                              from early
                        "Uncommitted                                                           adopters
                            Mass"

                              You cannot ignore the anchor draggers!

                        Management                                      Management
                         attention                                       attention

"The focal point really shouldn't be on THINKING with SIX SIGMA but on getting
                                   LEAN managing resistance,
people about the benefits of the change." -- Jeff Hiatt, president and CEO of Prosci
excited
How Do You Know When You are Lean?

40% reduction in assembly hours per unit
60% reduction in lead time                             You never get Lean,
92% reduction in line move time with SIX SIGMA
                                       LEAN THINKING   you only get Leaner
Some Lean Successes
Helicopter BCD Check: Reduced TAT from 28-
 14 days
Surveying Services: Exponentially increased
 flying hours for the photography aircraft. 10%
 increase in one week
Wellhead Turnover: Days to turnover reduced
Material Supply: Staging time reduced, scanners
 repaired, forklifts replaced.

                 LEAN THINKING with SIX SIGMA
Lean in Project Mgt and Construction

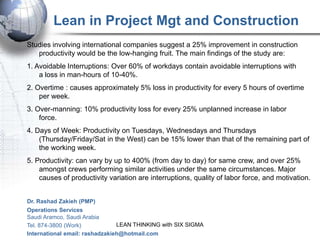

Studies involving international companies suggest a 25% improvement in construction
   productivity would be the low-hanging fruit. The main findings of the study are:
1. Avoidable Interruptions: Over 60% of workdays contain avoidable interruptions with
    a loss in man-hours of 10-40%.
2. Overtime : causes approximately 5% loss in productivity for every 5 hours of overtime
    per week.
3. Over-manning: 10% productivity loss for every 25% unplanned increase in labor
    force.
4. Days of Week: Productivity on Tuesdays, Wednesdays and Thursdays
    (Thursday/Friday/Sat in the West) can be 15% lower than that of the remaining part of
    the working week.
5. Productivity: can vary by up to 400% (from day to day) for same crew, and over 25%
    amongst crews performing similar activities under the same circumstances. Major
    causes of productivity variation are interruptions, quality of labor force, and motivation.

Dr. Rashad Zakieh (PMP)
Operations Services
Saudi Aramco, Saudi Arabia
Tel. 874-3800 (Work)            LEAN THINKING with SIX SIGMA
International email: rashadzakieh@hotmail.com
BOEING 737 FINAL ASSEMBLY
          BEFORE
  LEAN IMPLEMENTATION

LEAN THINKING with SIX SIGMA
LEAN THINKING with SIX SIGMA
The Boeing 737 Moving Line

       LEAN THINKING with SIX SIGMA
LEAN AGENDA
History
Definition
Goal
Process
Value Stream Mapping
 Kaizen
 Becoming Lean
 Lean and Quality
 Metrics
 Why Lean Fails
 Resistance
Six Sigma
Your Responsibility
How it ends
Resources LEAN THINKING with SIX SIGMA

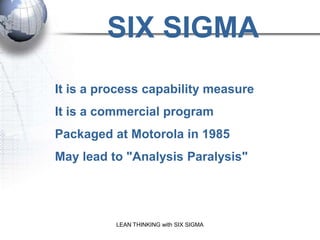

SIX SIGMA
It is a process capability measure
It is a commercial program
Packaged at Motorola in 1985
May lead to "Analysis Paralysis"

          LEAN THINKING with SIX SIGMA
Lean Focus - The 8 Wastes
Lean focuses on identifying and eliminating the 8 hidden wastes common to both
    manufacturing and service industries:
1. OVER-PROCESSING: Adding more value to a service or product than
    customers want or will pay for.
2. MOTION: Needless movement of people (looking for things).
3. TRANSPORTATION: Unnecessary movement of materials.
4. EXCESS INVENTORY: any work-in-process or raw material that is in excess of
    what is required to produce just-in-time for the customer.
5. WAITING: Any delay between when one process step/activity ends and the next
    step/activity begins.
6. DEFECTS: Any aspect of the product or service that does not conform to
    customer needs. (SIX SIGMA) Variation = defects
7. OVER-PRODUCTION: Production of service outputs or products beyond what is
    needed for immediate use.
8. UNUSED EMPLOYEE CREATIVITY: Losing time, ideas, skills, improvements,
    and learning opportunities by not engaging or listening to your employees.

                           LEAN THINKING with SIX SIGMA
Understanding Variation

Variation
means that a process or product does not
  produce the same results every time it is
  measured
is always present at some level
is inherent in every process or product
is our enemy in delivering services or
  manufacturing products,
reduction helps to improve quality, reduce
  costs, increase profits, and increase customer
  satisfaction.
               LEAN THINKING with SIX SIGMA
Lean Six Sigma Process Improvement

Lean Six Sigma uses the DMAIC process for
Project Management
Project Execution

            LEAN THINKING with SIX SIGMA

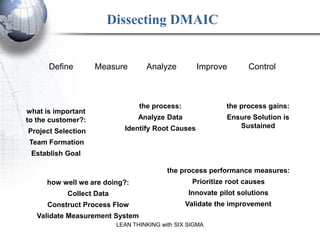

Dissecting DMAIC

      Define        Measure        Analyze         Improve         Control

                                 the process:               the process gains:
what is important
to the customer?:                Analyze Data               Ensure Solution is
                            Identify Root Causes               Sustained
Project Selection
Team Formation
 Establish Goal

                                          the process performance measures:
     how well we are doing?:                      Prioritize root causes
           Collect Data                          Innovate pilot solutions
      Construct Process Flow                    Validate the improvement
   Validate Measurement System
                          LEAN THINKING with SIX SIGMA
Y = f(x)
Y= f(x) , refers to a problem or process output (Y) , that is
the result of one or more process inputs (Xs) . Eliminating
or improving the Xs reduces or eliminates the problem
(Y) . Controlling the Xs provides a process that is more
   -   Predictable
   -   Reliable
   -   Capable
   -   Repeatable, and
   -   Dependable
The results are a Y that can be forecast, and a proactive
rather than reactive work environment.

                         LEAN THINKING with SIX SIGMA

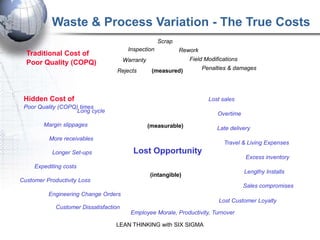

Waste & Process Variation - The True Costs
                                                      Scrap
                                         Inspection           Rework
  Traditional Cost of
                                        Warranty                  Field Modifications
  Poor Quality (COPQ)
                                    Rejects         (measured)         Penalties & damages

 Hidden Cost of                                                          Lost sales
 Poor Quality (COPQ) times
                    Long cycle                                               Overtime
        Margin slippages                           (measurable)              Late delivery
          More receivables
                                                                               Travel & Living Expenses
           Longer Set-ups                  Lost Opportunity
                                                                                        Excess inventory
     Expediting costs
                                                                                        Lengthy Installs
                                                   (intangible)
Customer Productivity Loss
                                                                                        Sales compromises
          Engineering Change Orders
                                                                             Lost Customer Loyalty
             Customer Dissatisfaction
                                          Employee Morale, Productivity, Turnover

                                   LEAN THINKING with SIX SIGMA
Understanding & Reducing Variation

# of
Goals

   Lower Specification                       Upper Specification
          Limit LEAN THINKING with SIX SIGMA        Limit
What Does Sigma Level Mean?

Example
      Lower                         Upper
   Specification                 Specification
       Limit
    (customer)
                                     Limit
                                  (customer)
                                                       Customers have
                   Target                              a target in mind,
                                                       but will allow
                                                       some variation
                                                       within the Spec
                                                       Range

                            LEAN THINKING with SIX SIGMA

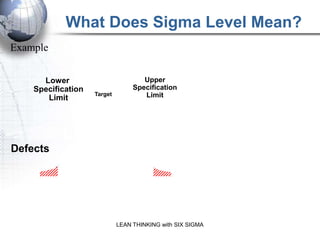

What Does Sigma Level Mean?
Example

      Lower                          Upper
    Specification                 Specification
       Limit
                    Target           Limit              Actual
                                                 Measurement has
                                                    Considerable
                                                       Variation
Defects                                      Defects - Resulting in
                                                   Scrap, Waste,
                                                  Late Deliveries,
                                                   and Customer
                                                   Dissatisfaction
                             LEAN THINKING with SIX SIGMA

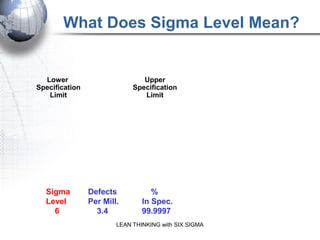

What Does Sigma Level Mean?
      Lower                           Upper
    Specification                  Specification
                     Target           Limit
       Limit
                                                      How Capable is
                                                      our Process to
                                                      Produce within
Defects                                       Defects
                                                          Spec?

       Sigma        Defects              %
       Level        Per Mill.         In Spec.
         2          308,500             69.1

 On Average it's OK -it's a Variation issue
 On Average it's OK - it's a Variation issue
                              LEAN THINKING with SIX SIGMA
                      BEWARE OF AVERAGES
What Does Sigma Level Mean?

  Lower                        Upper
Specification               Specification
   Limit                       Limit                     Reducing
                                                        Variation is
                                                      Clearly the Key
                                                       to Improving
                                                         Process
                                                        Capability

   Sigma        Defects           %
   Level        Per Mill.      In Spec.
     3          66,800           93.3
                       LEAN THINKING with SIX SIGMA
What Does Sigma Level Mean?

                                                Causes of
                                                Variation Include
  Lower                        Upper
Specification               Specification       a Variety of
   Limit                       Limit
                                                Factors, such as:

                                                1. Machines
                                                2. People
                                                3. Material
                                                4. Environment
                                                5. No Standard
   Sigma        Defects           %                  Work.
   Level        Per Mill.      In Spec.
     4           6,200           99.4
                       LEAN THINKING with SIX SIGMA
What Does Sigma Level Mean?
                                                  Variation Causes
                                                    Errors, which
  Lower                        Upper               Cause Defects,
Specification               Specification
   Limit                       Limit               which Lead to
                                                   Rework, and to
                                                  Processes which
                                                       are not
                                                  Stable
                                                  Reliable,
                                                  Repeatable, and
   Sigma        Defects           %
                                                  Predictable.
   Level        Per Mill.      In Spec.
     5           233             99.98
                       LEAN THINKING with SIX SIGMA
What Does Sigma Level Mean?
                                                          Reducing
                                                          Variation
  Lower
Specification
                                Upper
                             Specification
                                                       Reduces Errors,
   Limit                        Limit                      and the
                                                          Resulting
                                                         Defects and
                                                        Rework, and
                                                       therefore leads
                                                        to Improved
                                                           Process
  Sigma         Defects            %                      Capability
  Level         Per Mill.       In Spec.
    6             3.4           99.9997
                        LEAN THINKING with SIX SIGMA

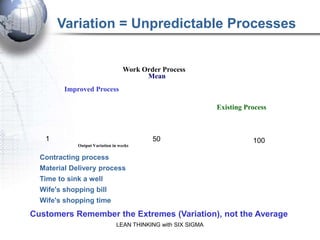

Variation = Unpredictable Processes

                                   Work Order Process
                                         Mean
         Improved Process

                                                              Existing Process

   1                                       50                            100
             Output Variation in weeks

  Contracting process
  Material Delivery process
  Time to sink a well
  Wife's shopping bill
  Wife's shopping time
Customers Remember the Extremes (Variation), not the Average
                               LEAN THINKING with SIX SIGMA

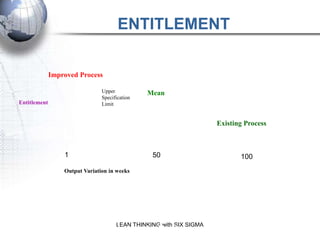

ENTITLEMENT

              Improved Process

                                Upper           Mean
                                Specification
Entitlement                     Limit

                                                                     Existing Process

                  1                              50                         100
                  Output Variation in weeks

                                      LEAN THINKING with SIX SIGMA
LSS Helps Us Consistently Deliver the Best We Can Do.
What Does Sigma Level Mean?

                        sure
       Lower
                  Mea y           Upper

        Limit
        evel is a bilit
     Specification             Specification
                                  Limit

     a L ss Capa
Sigm roce
   of P
    Sigma        Defects             %
    Level        Per Mill.        In Spec.

     2           308,500                 69.1
     3               66,800              93.3
     4                6,200              99.4
     5                 233               99.98
          LEAN THINKING with SIX SIGMA
     6                   3.4             99.9997
Practical Meaning of Six Sigma

                   3.8-Sigma
                   3.8-Sigma                                6-Sigma
                                                            6-Sigma                 3.4 defects per
                                                                                        million
                   99% Good
                   99% Good                             99.99966% Good
                                                        99.99966% Good               opportunities

20,000 lost articles of mail per hour                Seven articles lost per hour

5,000 incorrect surgical operations per              1.7 incorrect operations per week
  week

Two short or long landings at most                   One short or long landing every five
 major airports each day                              years

200,000 wrong drug prescriptions each                68 wrong drug prescriptions per year
  year

                                  LEAN THINKING with SIX SIGMA
Six Sigma Project Management Checklist

   Define
   Define                          Measure
                                   Measure                        Analyze
                                                                  Analyze                      Improve
                                                                                                Improve                           Control
                                                                                                                                  Control

  Identify Sponsor and other       Create Fishbone              Analyze Process Flow        Develop solution options           Perform Capability
key stakeholders                        Tie to defined               Critical Path              Improve control of          Analysis of improved
  Form project team                     defect                        Value-added                 significant root causes   process
        Team leader                Collect Data                       steps                       Re-design process to         Develop and Implement
        Team members                    Ys (results) with             Non value-                  obtain required           a Control Plan
  Tour process                          Xs (data tags)                added steps                 capability                   Complete Project
  Clarify project                  Evaluate Measurement               Opportunities               Perform DOE as            Closure Package
        Problem statement        Systems                        Analyze Data                       required                    Update financial
        Goal statement                  Gage R&R,                    Graphical tools         Evaluate options and select    benefits statement as
        Process output = Y          Understand detailed               Hypothesis          final solution                    required
  Define process                 process                              Tests                        Prioritization matrix            Get OCD focal
boundaries                               Detailed process             Interrelationship      Determine measurement                  final evaluation
       High level map                  map w/ rework                  Digraph (if         system for improved process         List best practices
       (SIPOC)                         loops                          appropriate.)          Create implementation plan             Identify lessons
  Define project boundaries        Describe Process                   Regression             Update FMEA                           learned
        Resources                       Numerical                     analysis               Update financial benefits
        Authority                       statistics              Identify and collect      statement                            Use SPC Charts
  Determine project timeline            Graphs: Time,         additional required data            Contact Six Sigma            Hand off project to
  Identify CTQ Customer                 Hist., Pareto, etc.     Identify significant Xs            OCD for concurrence      process owner
Requirements                            Create control                Tie to root            Obtain buy-in / support for           Create follow up
        Define the Defect                chart                        cause analysis      improvement actions                     action plan
        Define defect              Establish Process                  Draw                   Conduct pilot / testing to       Develop Final report out
         measure                 Capability                           conclusions         verify results                           Standard
   Develop estimate of                   DPMO or %               Perform FMEA                Implement improvements                template
potential financial benefit if          Defects                  Update charter as           Collect data to verify
project goal is achieved                Calculate Z           required                    improvement
   Gain Sponsor Approval of        Update Charter                Develop Analyze             Communicate results
Project Charter                        as required            report out                     Update Charter
   Identify Pull and Push           Develop Define/Measure            Standard                     as required
Leveraging opportunities         report out                           template              Develop Improve report out
                                         Standard template                                      For Sponsor

      Project Champion                                                                                Master Black Belt
LEAN AGENDA

 History
 Definition
 Goal
 Process
 Value Stream Mapping
  Kaizen
  Becoming Lean
  Lean and Quality
  Metrics
  Why Lean Fails
  Resistance
  Six Sigma
  Your Responsibility
How it ends
Resources LEAN THINKING with SIX SIGMA

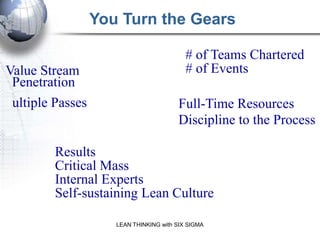

You Turn the Gears

                                           # of Teams Chartered
Value Stream                               # of Events
 Penetration
 ultiple Passes                         Full-Time Resources
                                        Discipline to the Process

         Results
         Critical Mass
         Internal Experts
         Self-sustaining Lean Culture
                                                    DEPLOYMENT METRICS
                     LEAN THINKING with SIX SIGMA

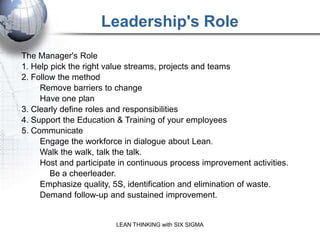

Leadership's Role
Senior Leadership
1.   Create the Vision
     - Where are we going and why are we going there?
2.   Align the Organization
     - Goals and Objectives
     - One Plan - One Initiative
3.   Participate in the Process
     - Don't just "talk it" , WALK IT
4.   Commit Resources
     - Right quantity and caliber
5.   Educate the Workforce
6.   Communicate
     - Vision, Results, Lessons Learned

                     LEAN THINKING with SIX SIGMA
Leadership's Role
The Manager's Role
1. Help pick the right value streams, projects and teams
2. Follow the method
     Remove barriers to change
     Have one plan
3. Clearly define roles and responsibilities
4. Support the Education & Training of your employees
5. Communicate
     Engage the workforce in dialogue about Lean.
     Walk the walk, talk the talk.
     Host and participate in continuous process improvement activities.
        Be a cheerleader.
     Emphasize quality, 5S, identification and elimination of waste.
     Demand follow-up and sustained improvement.

                         LEAN THINKING with SIX SIGMA
LEAN AGENDA

 History
 Definition
 Goal
 Process
 Value Stream Mapping
  Kaizen
  Becoming Lean
  Lean and Quality
  Metrics
  Why Lean Fails
  Resistance
  Six Sigma
  Your Responsibility
How it ends
Resources LEAN THINKING with SIX SIGMA

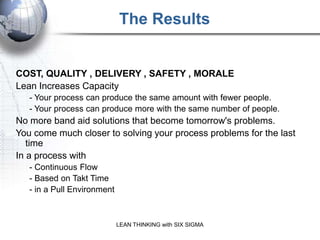

The Results
           REMEMBER: It is CONTINUOUS Process Improvement

COST, QUALITY , DELIVERY , SAFETY , MORALE
Lean Increases Capacity
   - Your process can produce the same amount with fewer people.
   - Your process can produce more with the same number of people.
No more band aid solutions that become tomorrow's problems.
You come much closer to solving your process problems for the last
   time
In a process with
   - Continuous Flow
   - Based on Takt Time
   - in a Pull Environment

                             LEAN THINKING with SIX SIGMA

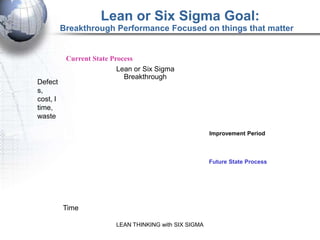

Lean or Six Sigma Goal:
          Breakthrough Performance Focused on things that matter

           Current State Process
                           Lean or Six Sigma
                             Breakthrough
Defect
s,
cost, l
time,
waste

                                                         Improvement Period

                                                         Future State Process

          Time

                          LEAN THINKING with SIX SIGMA
LEAN AGENDA

   History
   Definition
   Goal
   Process
   Value Stream Mapping
   Kaizen
   Becoming Lean
   Lean and Quality
   Metrics
   Why Lean Fails
   Resistance
   Six Sigma
   Your Responsibility
   How it ends
Resources LEAN THINKING with SIX SIGMA
Reading List
Lean Thinking
The Machine That Changed the World
Better Thinking, Better Results
Gemba Kaizen
High Velocity Culture Change
Learning to See
5 Pillars of the Visual Workplace
The Goal
Critical Chain
The Gold Mine THINKING with SIX SIGMA
                         LEAN
WEBSITES
- www.productivityinc.com
-   www.productivitypress.com
-   www.qualitypress.asq.org
-   www.sme.org
-   www.asq.org
-   www.crcpress.com
-   www.lean.org
-   www.nwlean.net
-   www.pmi.org
-   www.qualitydigest.com
-   www.isixsigma.com
            LEAN THINKING with SIX SIGMA
LEAN AGENDA

History
Definition
Goal
Process
Value Stream Mapping
Kaizen
Becoming Lean
Lean and Quality
Metrics
Why Lean Fails
Resistance
Six Sigma
Your Responsibility
How it ends
Resources LEAN THINKING with SIX SIGMA
SHUKRAN JAZEELAN

Cutting costs, improving quality, & speeding delivery through continous improvement

  • 1.
    LEAN THINKING with Six Sigma Cutting Costs, Improving Quality, & Speeding Delivery By Continuous Process Improvement Prepared By: Kurt E. Robertson Organization Consulting Department Saudi Aramco 874-6204
  • 2.
    The Robertson Guarantee IFYOU KEEP ON DOING WHAT YOU HAVE ALWAYS DONE YOU WILL KEEP ON GETTING WHAT YOU'VE ALWAYS GOT. I PROMISE LEAN THINKING with SIX SIGMA
  • 3.
    PRESENTATION OBJECTIVE To Provide a brief overview of Lean & Six Sigma. Things you should know about Lean: Lean and Six Sigma can be successfully applied in both operations and service environments Automation shouldn't be the first answer Both Lean and Six Sigma are data driven Lean is Team-based Lean takes a Systems Approach Lean is a: physical transformation to your processes LEAN THINKING with SIX SIGMA transformation of your organization cultural
  • 4.
    LEAN IS ABOUTPEOPLE EMPOWERMENT Empowerment does not mean total freedom; it is the ability to make choices within boundaries. It is focused freedom. A shared vision of what we want to create provides the focus and direction that ensures that empowerment does not lead to chaos. Center for Study of Work Teams Harley Davidson Company LEAN THINKING with SIX SIGMA
  • 5.
    Lean compared toSix Sigma Lean and 6 å are like the Democrats and the Republicans in the U.S. Congress - they both think they are right, and that you are wrong if you don't agree with them - very few from one side ever change sides - some of their methods and decisions are sub-optimal - but each adds balance to the process when applied reasonably and knowledgeably Lean focuses on: - reducing the 8 Wastes - Improving process flow - Increasing process speed Lean cannot always bring a process under statistical control Six Sigma helps: - reduce process variation (one of the 8 wastes) - reduce defects Six Sigma alone cannot dramatically optimize process flow and reduce wastes Because of their complementary natures , each brings to the improvement process something the other does not, and the fusion of Lean and 6 å is rapidly gaining popularity. LEAN THINKING with SIX SIGMA DO LEAN FIRST before SIX SIGMA 99% of the time
  • 6.
    Complementary Tools 6 Sigma OVERALL YIELD vs SIGMA (Distribution Shifted ñ1.5 å ) # of Steps 1 93.32% 99.379% 99.9767% 99.99966% 7 61.63 95.733 99.839 99.9976 ion 10 50.08 93.96 99.768 99.9966 20 25.08 88.29 99.536 99.9932 40 60 6.29 1.58 77.94 68.81 riat 99.074 98.614 99.9864 99.9796 80 0.40 60.75 sv a 98.156 99.9728 L les 100 0.10 53.64 97.70 99.966 150 --- 39.38 96.61 99.949 ps - 200 --- 28.77 95.45 99.932 E 300 --- 15.43 93.26 99.898 rs te 400 --- 8.28 91.11 99.864 500 --- 4.44 89.02 99.830 A 600 700 --- --- we 2.38 1.28 86.97 84.97 99.796 99.762 N 800 --- fe 0.69 83.02 99.729 s te- 900 --- 0.37 81.11 99.695 1000 --- 0.20 79.24 99.661 wa 1200 --- 0.06 75.88 99.593 3000 --- --- 50.15 98.985 17000 s --- --- 1.91 94.384 Les 38000 70000 --- --- 0.01 87.880 78.820 150000 60.000 Source: SIX SIGMA RESEARCH INSTITUTE Motorola University Motorola, Inc. LEAN THINKING with SIX SIGMA
  • 7.
    Combining Lean andSix Sigma Lean reduces cost, improves quality, and speeds delivery by eliminating non-value added activity in a process by identifying and eliminating waste . Six Sigma is a more data-driven approach which aims to reduce cost, improve quality, and speed delivery by process variability and defects using the five-step DMAIC reducing model. 6 å depends heavily on data mining and data integrity. Lean Six Sigma: Any combination should maintain the integrity of each discipline while combining the benefits of each. Attempting to make one look like a part of the other Sub-optimizes both . Problem complexity often determines which to use. Don't use a hammer to crack a peanut shell . LEAN THINKING with SIX SIGMA
  • 8.
    When to useLean or Six Sigma Lean is an AXE . Use Lean if: This is the first and or second pass at identifying and eliminating waste Process problems include: flow operator cycle time product lead time delivery time quality costs You need rapid improvement You need a mile-wide, inch-deep approach Six Sigma is a SCALPEL . Use Six Sigma if: Lean has made a first pass with improvement Defects and variation still persist and you need refined data analysis with an inch-wide, mile-deep approach Lean is not about tinkering withSIX SIGMA existing processes. LEAN THINKING with your
  • 9.
    Harvesting the Fruitof Lean Six Sigma Difficult-to-Reach Fruit Production Preparation Process (PPP) Design for Six Sigma (DFSS ) Middle Fruit Six Sigma tools ---------------------------------- Low-Hanging Fruit Degree Lean tools of ---------------------------------- Complexity Ground Fruit Logic and Intuition LEAN THINKING with SIX SIGMA
  • 10.
    Let's Talk LeanFirst Do Lean First in most cases And you should LEAN THINKING with SIX SIGMA
  • 11.
    AGENDA History Definition Goal Process Value Stream Mapping Kaizen BecomingLean Lean and Quality Metrics Why Lean Fails Six Sigma Resistance Six Sigma Your Responsibility How it ends LEAN THINKING with SIX SIGMA Resources
  • 12.
    Lean History 15 thCentury 1905 1945-1973 1973 1974-2005 1973-2005 The Republic "Today and The Toyota Oil Embargo Books about : Boeing of Venice Tomorrow" Production JIT Danaher by System Cellular Manufacturing U.S. Navy Henry Ford Visual Factory U.S. Air Force Agile Manufacturing Airbus W. Edwards Flexible Manufacturing Dell Computer Deming Synchronous Mfg Maytag Pull Production Whirlpool Rapid Continuous McDonald's Improvement Microsoft Kaizen Group Technology And most companies that have tried MIT Theory of Constraints "The Machine That and Six Sigma Changed the World" "Lean Thinking" LEAN SIX SIGMA by James Womack Time LEAN THINKING with SIX SIGMA
  • 13.
    AGENDA History Definition Goal Process Value Stream Mapping Kaizen BecomingLean Lean and Quality Metrics Why Lean Fails Resistance Your Responsibility How it ends Resources LEAN THINKING with SIX SIGMA
  • 14.
    LEAN Is based onthe Toyota Production System Is the Identification and Elimination of WASTE in the Process Got its name from MIT and James Womack's research team Is process simplification , and the relentless removal of waste from all processes Improves Quality, Cost, Delivery, Safety, Morale ( QCDSM ) Increases process capacity Reduces defects Results in a stable,THINKING with SIXrepeatable, predictable LEAN reliable, SIGMA process
  • 15.
    General Rules 1. Leanis about fixing the SYSTEM and transforming the CULTURE (CM). 2. Lean is about FLOW. 3. Lean is about people , not just about improvement tools. 4. Lean is about YOUR expectations and about what YOU are willing to tolerate in terms of Q uality, C ost, D elivery, S afety, and M orale (QCDSM) . 5. Processes rarely get better on their own. 6. Successful processes have rules , standards , & absolutes . 7. To solve a problem you have to admit you have one. 8. Problems need to be quantitatively defined and their corrective action quantitatively tracked. System) . (Measurement 9. Every project needs a Value Stream Champion. LEAN THINKING with SIX SIGMA
  • 16.
    The System Planning Material Supply Operations Sales and Marketing Value Stream Value Stream LEAN THINKING with SIX SIGMA
  • 17.
    WASTE Waste is any activity that: 1. The customer isn't willing to pay for. 2. Doesn't positively change the form, fit, or function of the product or service (Value Added)
  • 18.
    If it preventsthe FLOW of product or information.. LEAN THINKING with SIX SIGMA
  • 19.
    Lean Focus -The 8 Wastes Lean focuses on identifying and eliminating the 8 hidden wastes common to both manufacturing and service industries: 1. OVER-PROCESSING: Adding more value to a service or product than customers want or will pay for. A 15 page report when 1 page would do. Design Engineer enhancing or modifying customer specifications. PROCESS COMPLEXITY 2. MOTION: Needless movement of people (hunting, searching, gathering things). 3. TRANSPORTATION: Unnecessary movement of materials. 4. EXCESS INVENTORY: Work-In-Process (WIP) or raw material (RM) that is in excess of what is required to produce Just-In-Time (JIT) for the customer. 5. WAITING: Any delay between when one process step/activity ends and the next step/activity begins. 6. DEFECTS: Any aspect of the product or service that does not conform to customer needs. (SIX SIGMA) Variation = defects 7. OVER-PRODUCTION: Production of service outputs or products beyond what is needed for immediate use. 8. UNUSED EMPLOYEE CREATIVITY: Losing time, ideas, skills, improvements, and learning opportunities by not engaging or listening to your employees. -- The Toyota Production System LEAN THINKING with SIX SIGMA
  • 20.
    The 9 thWaste - HASTE - American (or Western adage): "Haste makes waste." "If you don't have time to do it right, when will you have time to do it over?" -- J. Raymond Robertson LEAN THINKING with SIX SIGMA
  • 21.
    Understanding FLOW LEANTHINKING with SIX SIGMA
  • 22.
    Why Lean? Business asUsual CUSTOMER Waste PRODUCT ORDER BUILT & SHIPPED Lead-time Lean Process CUSTOMER PRODUCT ORDER BUILT & SHIPPED Waste Lead-time (Shorter) LEAN THINKING with SIX SIGMA
  • 23.
    Why Lean? Typical Value Stream Ratio of Value-Added to Non-Value-Added Activity 3% 97% NVA VA Where's Most Process Improvement the Real Teams Attack this . . . Opportunity? 97% NVA . . . Achieve this . . . . . . and Ignore this Source: C. Fiore; Lean Strategies for Product Development , ASQ, 2003 LEAN THINKING with SIX SIGMA
  • 24.
    Excess Inventory Our corporate body guard against bad processes A $ea of RM & WIP Reduce the inventory and see the wa$te ! LEAN THINKING with SIX SIGMA You can `t be Lean unless your suppliers are Lean.
  • 25.
    Who Is Lean?? FireFighters Hospital Emergency Rooms Lifeguards Boeing (Leaner) Where lives are at risk, you will probably find Lean processes. What about the rest of us?? LEAN THINKING with SIX SIGMA
  • 26.
    Typical Causes ofWaste 1. Layout (distance) 2. Long set-up time 3. Poor work methods 4. Lack of training 5. Functional organizations 6. Technology Gaps 7. Little understanding of the entire process 8. Historic supervisory roles 9. Irrelevant performance measures 10. Lack of workplace organization 11. Supplier quality/reliability 12. Poor communication 13. Avoidable interruptions 14. Complexity LEAN THINKING with SIX SIGMA 15. More.
  • 27.
    Non-Value-Adding Activities (Operations) "Non-value-adding" activity (NVA) consumes time and money...but does not change the value of an item. 1. SORTING 2. COUNTING 3. STACKING 4. EXPEDITING 5. TRANSFERRING 6. CHECKING 7. TRANSPORTING 8. HUNTING, SEARCHING, GATHERING LEAN THINKING with SIX SIGMA
  • 28.
    Non-value-adding (NVA) (office) Examples 1. CHECKING 2. SIGNATURES 3. ASKING 4. APPROVING 5. REVIEWING 6. MONITORING 7. REWORK 8. TRANSPORTING 9. DOUBLE HANDLING 10.HUNTING, SEARCHING, GATHERING LEAN THINKING with SIX SIGMA
  • 29.
    The Goal ofLean Improved product Q uality, C ost, D elivery; Improved employee S afety and M orale ( Q C D S M) in any operational or service process. 1. By establishing (one-piece) Flow Based in Takt Time In a Pull environment (JIT) 2. But first I need processes that are: Stable Reliable Predictable Repeatable 3. I get those processes by establishing: Awareness - at all levels of the organization 5S - Workplace organization Value Stream Mapping - information and material flow Flow - improve plant or office layout Leveled Production - reduce lot sizes, setup time, lead times, LEAN THINKING with SIX SIGMA inventory
  • 30.
    Lean Kaizen Sequence Processescan be transformed Distribution in days, weeks or months, System Kaizen One-piece flow but plan 1- 6 years Pull/Kanban Takt time for the corporate Equipment Kaizen (TPM) transformation 3P, Autonomation Leveled Production Line Balancing Reduce: lot sizes, setup times, lead times, operator cycle times, inventory AWA FLOW: AIWs (Gemba Kaizen) REN Factory Layout Kaizen Standard Work: Operator Methods ESS process simplification, quality and maintenance - 5S - Organize the workplace LEAN THINKING with SIX SIGMA
  • 31.
    The Lean Toolbox 1. Value Stream Maps 17. SIX SIGMA 2. Rapid Improvement (Kaizen) 18. Chaku-Chaku / Load-Load Events 19. Heijunka / Load Leveling 3. Education 20. Bottlenecks 4. Employee Involvement 21. Point-of-Use Delivery 5. Metrics and Alignment 22. DFMA 6. Flow Cells 23. Control Charting 7. Standard Work 24. Pareto Analysis - Capacity Analysis 25. Histograms - Takt Time / Cycle Time 26. Root Cause Analysis Standard Ops Worksheet 27. 5 Why's - Production Control Board 28. Hypothesis Testing 8. 5S / Visual Controls 29. Supply Chain Management 9. Pull/Kanban Systems 30. Critical Chain Project 10. Brainstorming Management 11. Prioritization 31. 7 Quality Control Tools 12. Spaghetti Chart 32. 7 Management & Planning 13. Poka-Yoke / Mistake Proofing Tools 14. Set-up Reduction 33. Nominal Group Technique 15. Total Productive Maintenance with SIX 34. Production Process LEAN THINKING SIGMA 16. Change Management Preparation (3P)
  • 32.
    How Do IKnow Which Tool To Use? How do you know whether to use Microsoft: - Excel - PowerPoint - Word - Access - Project - Visio Excel is probably not the best choice for word processing. Word is probably not the best choice for calculations. **The KNOWLEDGEABLE, EXPERIENCED use of a tool is the key to the SUCCESSFUL use of a tool** LEAN THINKING with SIX SIGMA
  • 33.
    AGENDA History Definition Goal Process ValueStream Mapping Kaizen Becoming Lean Lean and Quality Metrics Why Lean Fails Resistance Six Sigma Your Responsibility How it ends Resources LEAN THINKING with SIX SIGMA
  • 34.
    Team Charter Dates: VSM Impact RIE Senior Management Sponsor: Project Value Stream Champion: Just Do It Difficulty Project Description: Team Leaders and Members: Potential Implementation Costs: Business Reason for the Project: Project Constraints (Financial, Personnel, Equipment): Expected ROI: LEAN THINKING with SIX SIGMA
  • 35.
    Definition of aValue Stream The VALUE STREAM is the entire set of processes or activities designed to transform the products and services into what is required by the customer. The VALUE STREAM Suppliers Design Procure Make Sell Customers A Primary Focus is TIME, Product and / or Service Flow Information Flow: Quickly SIGMA Directions In All
  • 36.
    Define the Boundaries start stop What keeps you awake at night? suppliers inputs Value stream outputs customers Where are the stakes in the ground that define your Value Stream boundaries? - We'll focus our efforts between them! LEAN THINKING with SIX SIGMA
  • 37.
    Value $tream Map- Finding the WA$TE Production Control 90/60/30 day 6 week forecasts SUPPLIER forecast CUSTOMER MRP Daily Weekly Order 500 ft coils Fax 18400 pieces/month Daily Ship -12000- L Weekly Schedule Schedule - 6400- R Tues. & Tray = 20 pieces Thurs. 2 shifts Ass'y Ass'y Stampin S. Weld S. Weld #1 #2 Shipping g #1 #2 I I I I I I 1 1 1 1 1 Staging Coils 4600 L 1100 L 1600 L 1200 L 2700 L 5 days 2400 R 600R 850R 640R 1440R C/T=1 sec C/T=39 sec C/T=46 sec C/T=62 sec C/T=40 sec C/O=1 hour C/O=10 m C/O=10 m C/O = 0 C/O = 0 .0014% VA Uptime = Uptime = Uptime = Uptime = Uptime = 85% 100% 80% 100% 100% 27,600 *2 27,600 *2 27,600 *2 27,600 *2 27,600 *2 sec. avail. sec. avail. sec. avail. sec. avail. sec. avail. 5 days 7.6d 1.8d 2.7d 2d 4.5d PLT = 23.6 days 1 sec 39 sec 46 sec 62 sec 40 sec Process Time (VAT) = 188 sec. LEAN THINKING with SIX SIGMA
  • 38.
    Current State Value StreamMap Current State - March '02 AREA: Harrier Maintenance Flight (500 Hour Minor) BUSINESS CASE: VALUE STATEMENT: KEY REQUIREMENTS: MEASUREMENTS: IDEAL STATE: Improve Harrier Maintenance Flight Identify, remove and repair failed, broken, or Core Manpower Requirements Productivity (hours per unit) ON DEMAND Operating Performance obsolete parts for Harrier W eapon Platform, Operational Risk Throughput Time DEFECT FREE functional test, and reapply finish Quality and Flight Safety On Time Delivery 1 BY 1 Cost of other Platforms Floor Space LOW EST COST LEAN THINKING with SIX SIGMA Future State Implementation Pan
  • 39.
    Current State Map Totaltime: 156 hrs waiting time: 148 hrs Value added time: 8 hrs (5%) No. of steps: 63 Defect rate: 10% Backlog: 2 weeks LEAN THINKING with SIX SIGMA Distance traveled: 1.2 km
  • 40.
    Spaghetti Charts Communication andMotion LEAN THINKING with SIX SIGMA
  • 41.
    IN CHARGE OFFOLLOWUP: Project Name Status of overall completion = % 28 Plan Dates ACTION Who Comments %Status Start Finish PROJECT SUMMARY: In charge C COMPL of Action Department this BEGIN ET E Comments 40 item ASD / 7/3/200 7/10/200 AAD to AJD:Follow-up this action item and 1 100 MZU 7 7 report completion AJD / AAD to AJD: Make sure this is done ASD 7/3/200 8/10/200 2 MAS: You can decide where the 5 / 7 7 location of the hotline be. MZU ASD / 7/3/200 8/10/200 3 100 MZU 7 7 LEAN THINKING with SIX SIGMA
  • 42.
    LEAN AGENDA History Definition Goal Process Value StreamMapping Kaizen Becoming Lean Lean and Quality Metrics Why Lean Fails Resistance Six Sigma Your Responsibility How it ends Resources LEAN THINKING with SIX SIGMA
  • 43.
    Kaizen = continuousimprovement RAPID IMPROVEMENT At the end of the week, a new process should be in place. Anything else is not rapid improvement. It's a "STUDY". LEAN THINKING with SIX SIGMA
  • 44.
    Team Charter Dates: VSM Impact RIE Senior Management Sponsor: Project Value Stream Champion: Just Do It Difficulty Project Description: Team Leaders and Members: Potential Implementation Costs: Business Reason for the Project: Project Constraints (Financial, Personnel, Equipment): Expected ROI: LEAN THINKING with SIX SIGMA
  • 45.
    Rapid Improvement Events(RIE) Action oriented - "leaned" process in place and functioning by close of event - creativity before capital Learning by doing Transform the Value Stream Structure - 3-5 days in length - 3-5 teams cross-functional teams - 6-8 people per team - Seven week improvement cycle 3 weeks preparation 1 week execution 3 weeks follow-up LEAN THINKING with SIX SIGMA
  • 46.
    RIE Preparation Checklist RapidImprovement Events By: Date: Prep. % COT: PREPARATION Team: 3rd Week Before Event: (% COT: ) 2nd Week Before Event: (% COT: ) 1st Week Before Event: (% COT: ) 1) Identify the suppliers and inputs 1) Communicate key metrics, targets, and 1) Select the Value Stream from the 2) Identify the customers and outputs tools to be applied to all team participants Enterprise 3) Identify the start / stop boundaries 2) Train team participants on improvement Transformation Plan. 4) Gather facts and data to populate starting process and tools to be applied 2) Select the target area from Value Stream numbers on Target Progress Report 3) Identify what "triggers" work Analysis. 5) Populate the Target Progress Report 4) Double check availability of all resources: 3) Determine the focus - which Lean tools 6) Identify top three improvement metrics - equipment or furniture moves will be applied? 7) Establish improvement targets on top three - computer or phone moves 4) Identify the Team Leader, Co-Leader, and metrics, be aggressive - 5S, shadowing, kitting Team Members. 8) Meet with affected stakeholders to - Production Control Boards 5) Assure at least 1/3rd of participants are communicate Improvement Event schedule, 5) Communicate with affected area, review from the affected area. metrics, targets, and tools to be applied items listed on flip chart and ask for 6) Clear participants calendars for the 9) Set a flip chart up in affected area, ask clarification, make sure these are added to Improvement Event Week. stakeholders to put ideas for improvement Improvement Newspaper 7) Complete the Team Roster. on flip chart. Start Improvement Newspaper. 6) Make sure team break-out area is ready: 10) Capture flow stopper information from - flip charts, markers, post-its, VSA blanks Production Control Boards - forms, stop watches 11) Confirm the availability of any special 7) Make sure Process Champion is set resources for: to give opening remarks on Monday - equipment or furniture moves morning - computer / phone moves 8) Make sure Process Champion is available - 5S, shadowing, kitting for Team Leader Meetings Monday - - Production Control Boards Wednesday 12) Obtain any special data collection 9) Schedule Final Presentation with Process instructions from your Coach such as: Champion and appropriate leadership - Information from previous Improvement 10) Plan working lunches Events 11)Confirm all team participants are going to - Customer critical to quality issues be available full time for entire event - Safety data 12) Confirm Target Progress Report and 13) Confirm all participants are still available Team Roster are complete for entire Event week LEAN THINKING with SIX SIGMA
  • 47.
    RIE Daily Checklist RapidImprovement Events TEAM DAILY CHECKLIST Day One. Day Two. Day Three. Day Four. 1. Review team goals and objectives, create Day 1 plan. 1. Identify wastes to attack. 1. Train Stakeholders on new cell layout and standard 1. Train Stakeholders on new cell layout and work. standard work 2. Meet with Cell Stakeholders and review goals. 2. After TAKT time/Cycle time bar charts. (loading diagram) 2. Assign a team member to each Stakeholder. 2. Assign a team member to each Stakeholder. 3. Before Data, Documentation and "Tools" TAKT Time Calculation 3. Create plan for new cell layout. 3. Run new cell. 3. Run new cell. Before Time Observations Before Cycle Time Bar Charts (Loading Diagrams) 4. Meet with Stakeholders, review progress and plans 4. Fix problems immediately. 4. Create/post Key Point, Work Combination Sheets, Before Standard Work Sheet/Cell Layout solicit ideas and concerns. Standard Work Sheet, Production Control Board, Before WIP Count ($ and pieces) 5. Create production control board. and Kaizen Newspaper. Before 6S Audit 5. After standard work combination sheets. Before Safety Audit 6. Work on 6-S and safety issues. 5. Fix problems immediately. Before Work Combination Sheets (one per operator) 6. Notify support groups by 2.00 PM of required support. 7. Create/post Key Point, Work Combination Sheets, 6. After 6-S and safety audits. 4. Take a "Waste Walk", to further identify opportunities. Standard Work Sheet, Production Control Board, 7. Daily recap. and Kaizen Newspaper. 7. Off shop floor by 1:00. 5. Daily recap. 8. Create daily plan for Wednesday. 8. Daily recap. 8. After area pictures and Team picture. 6. Meet with Stakeholders and review progress.ideas. 9. Team Leader/Co Leader. How late do we stay? 9. Create daily plan for Thursday. 9. Prepare final presentation. 7. Create daily plan for Tuesday. 10. Daily Team Leader meeting. 10. Team Leader/Co Leader. How late do we stay? 10. Complete Team/Event binder. 8. Team Leader/Co-Leader. How late do we stay? 11. 6-S meeting area. 11. Daily Team Leader meeting. 11. 6-S meeting area. 9. Daily Team Leader meeting. 12. Implement plan/create cell. 12. 6-S meeting area. 12. Inventory kit boxes and find missing articles. 10. 6-S meeting area. ** Team Leaders need to assign action items ** Team Leaders need to assign action items ** Team Leaders need to assign action items ** Team Leaders need to assign action items to specific people on the teams and require to specific people on the teams and require to specific people on the teams and require to specific people on the teams and require with SIXup reports on progress at a minimum follow increments. follow up reports on progress at a minimum of two hour increments. follow up reports on LEAN progress at a minimum of two hour increments. of two hour SIGMA follow up reports on progress at a minimum of two hour increments. THINKING
  • 48.
    LEAN AGENDA History Definition Goal Process Value StreamMapping Kaizen Becoming Lean Lean and Quality Metrics Why Lean Fails Resistance Six Sigma Your Responsibility How it ends Resources LEAN THINKING with SIX SIGMA
  • 49.
    The 5S Principles: Proper arrangement and orderliness "Good factories (workplaces) develop beginning with the 5Ss; bad factories fall apart beginning with the 5Ss." -Hiroyuki Hirano
  • 50.
    5S Workplace Organization 1.SORT (seiri): Clearly distinguish what is necessary & what is not. Remove what does not support an organized, visual and Lean workplace. 2. SIMPLIFY (seiton): Ensure everything required to do the task has a visually designated location, is available, functional, and can easily be seen, reached and returned in the sequence used; Consider an operating room or fire engine. Mark/label locations clearly. 3. SWEEP (seiso): Keep the work area, tools and equipment - Floors, machines, desks, files, equipment - organized, organized, repaired (TPM), and visually marked. 4. STANDARDIZE (seiketsu): Maintain & improve the first 3S's. Establish procedures so storage and cleaning actions are consistently applied by everyone. 5. SUSTAIN (shitsuke): Hold the gains. Achieve the discipline/habit of following the correct procedures. From this new level of efficiency, start again. LEAN THINKING with SIX SIGMA
  • 51.
    Visual Controls A Major Element of 5S Visual controls: - Answer a question before it is asked - Help spot abnormalities in the system - Examples: Medical - Moment of Truth KSA/Bahrain Causeway booth lights: - Avg and Std Dev LEAN THINKING with SIX SIGMA
  • 52.
    The 5S's Low Level of 5S 1. Sort Needed from the unneeded 2. Shine Clean, scrub, and fix 3. Set in order High Level of 5S A place for everything 4. Standardize A plan to sustain 5. Sustain Following through LEAN THINKING with SIX SIGMA
  • 53.
    Standard Work Board TAKT time & Delivery Performance Measure Andon Flag Cell Key Measures 6S Layout and Assignments Corrective Action Matrix and Plan Standard Work Bar Chart LEAN THINKING with SIX SIGMA
  • 54.
  • 55.
    Shadow Hand Tools LEAN THINKING with SIX SIGMA
  • 56.
    Signal Lights LEAN THINKING with SIX SIGMA
  • 57.
    Visual Management Shadowing Labeling Foot-printing LEAN THINKING with SIX SIGMA Production Color Schemes Striping Control Boards
  • 58.
  • 59.
    Visual Controls LEANTHINKING with SIX SIGMA
  • 60.
    Other Visual &Audio Controls Visual and Audio controls answer questions before they are asked. 1. Clock 2. Traffic lights with a timer 3. Traffic Lines/ lights/signs 4. Sounds announcing break time 5. Call to Prayer 6. Score boards at sporting events 7. Arrival/Departure boards in airports 8. Lights indicating machine or process condition 9. Lights and siren on emergency vehicles 10. Gauges on medical & industrial equipment 11. Big teeth on a snarling lion 12. Take-a-Number systems 13. Colored caps on milk bottles LEAN THINKING with SIX SIGMA
  • 61.
    Point-of-Use Strategy: 7Elements of Surgery Information Hand Tools Instruments Power Tools 7 Elements Supplies Of Surgery Fixtures Fasteners LEAN THINKING with SIX SIGMA
  • 62.
    Supermarket Pull System Kanban Kanban Supplying Customer Process product product Process Supermarket Customer Process goes to supermarket and withdraws what it needs when it needs it. Supplying Process produces to replenish what was withdrawn. Purpose: Controls production at supplying process without tying to schedule. Controls production between flows. LEAN THINKING with SIX SIGMA
  • 63.
    Pull/Kanban Systems Pull OnDemand - Upstream Supplier - Downstream User - Visual Trigger Sequenced - Use FIFO lanes Replenished - Create supermarkets with SIX SIGMA LEAN THINKING
  • 64.
    Traditional vs CellularFlow Dept 1 Traditional flow Cellular flow Dept 2 DONE 4 3 IN OUT OUT IN IN 1 2 Dept 3 Dept 4 Demand paced production OUT IN IN Value-adding steps in order OUT No stops, piles, or back-ups DONE Flexible Less transportation Less work-in-process LEAN THINKING with SIX SIGMA
  • 65.
    U - ShapedCell Andon RM FG LEAN THINKING with SIX SIGMA
  • 66.
    Other Important LeanTools 1. Setup Reduction 2. Standard Operations 3. Times - Operator Cycle Time - Product Lead Time - Waste Time - Takt Time (customer driven) 4. Total Productive Maintenance (TPM) 5. Production Preparation Process (PPP) 6. Bottleneck reduction 7. Mistake proofing (Poke Yoke) (Example: mobile SIM card) 8. 5 Whys 9. Self-Inspection and Acceptance (SI&A) LEAN THINKING with SIX SIGMA
  • 67.
    Lean Implementation Sequence Distribution System Kaizen One-piece flow Pull/Kanban Takt time PEO Equipment Kaizen (TPM) 3P, Autonomation PLE Leveled Production Line Balancing Reduce: lot sizes, setup times, lead times, operator cycle times, inventory AWA FLOW: AIWs (Gemba Kaizen) REN Factory Layout Kaizen Standard Work: Operator Methods ESS process simplification, quality and maintenance - 5S - Organize the workplace LEAN THINKING with SIX SIGMA
  • 68.
    LEAN AGENDA History Definition Goal Process Value StreamMapping Kaizen Becoming Lean Lean and Quality Metrics Why Lean Fails Resistance Six Sigma Your Responsibility How it ends Resources LEAN THINKING with SIX SIGMA
  • 69.
    How Does LeanHelp Quality? RULE #1: Do not make, accept or pass on a defect. RULE #2: Inspection is the enemy of quality. RULE #3: The operator is responsible for identifying, tracking and correcting his defect rate. By using standard work, reducing bottlenecks, and using other Lean tools, Lean makes processes - stable - reliable - predictable - repeatable The HIDDEN FACTORY: Lean will not succeed without addressing and correcting variation and its resulting defect rate, because FLOW cannot exist in a process with a high defect rate. Our processes have THINKING with SIX SIGMA LEAN high defect TOLERATE high defect rates rates because we
  • 70.
    AGENDA History Definition Goal Process Value Stream Mapping Kaizen Becoming Lean Lean and Quality Metrics Why Lean Fails Resistance Six Sigma Your Responsibility How it ends Resources LEAN THINKING with SIX SIGMA
  • 71.
    Implementation Metrics Leading Indicators 1. Cycle Time 2. Inventory (amount, turn rate, IRA) 3. Productivity 4. Square Feet (foot print) 5. Set-up Time 6. Product Lead Time Lean is data driven 7. People Travel 8. Product Travel 9. Volume 10. Crew Size 11. Safety/Ergonomics LEAN THINKING with SIX SIGMA
  • 72.
    METRICS - TheForensics of CPI 1. What gets measured gets fixed . 2. If you can measure it, you can change it. 3. Metrics drive behavior . Tell me how you will measure me and I will tell you how I will perform. 4. The folly of rewarding A while hoping for B . 5. Measure first, then manage. 6. Leading indicators versus Lagging indicators (NDE)- Always reviewing the past , and not guiding the future . Manage the leading indicators, and the lagging indicators will be O.K. 7. Problems must be quantified, exposed and confronted . Lean cannot remedy an unacknowledged or hidden problem. 8. Don't measure effort and process compliance. Measure results. 9. What you allow, you encourage. 10. Your Recommendations are only as good as your analysis. Your analysis is only as good as your data. Your data is only as good as you measurement system. Data Integrity is the foundation of a credible project. LEAN THINKING with SIX SIGMA
  • 73.
    AGENDA History Definition Goal Process Value Stream Mapping Kaizen Becoming Lean Lean and Quality Metrics Why Lean Fails Resistance Six Sigma Your Responsibility How it ends Resources LEAN THINKING with SIX SIGMA
  • 74.
    Reasons Lean Fails 1.No sense of urgency (burning platform) 2. Looking for a quick fix (lean pill) 3. No leadership commitment and support Awareness Full-time practitioners 4. No education and awareness among the employees and management. (CM) 5. No understanding of Lean (flavor of the month) 6. No Sensei (Do-It-Yourself Lean) 7. No Value Stream Map 8. No implementation or sustaining plan (PM) 9. No customer and supplier involvement in the improvement process. LEAN THINKING with SIX SIGMA
  • 75.
    AGENDA History Definition Goal Process Value Stream Mapping Kaizen Becoming Lean Lean and Quality Metrics Why Lean Fails Resistance Six Sigma Your Responsibility How it ends Resources LEAN THINKING with SIX SIGMA
  • 76.
    Managing Resistance Traditional Situation Leading Change Increasing Increasing Increasing Increasing Neutral Neutral resistance cooperation resistance cooperation Critical mass Early adopters Anchor draggers Strong pull from early "Uncommitted adopters Mass" You cannot ignore the anchor draggers! Management Management attention attention "The focal point really shouldn't be on THINKING with SIX SIGMA but on getting LEAN managing resistance, people about the benefits of the change." -- Jeff Hiatt, president and CEO of Prosci excited
  • 77.
    How Do YouKnow When You are Lean? 40% reduction in assembly hours per unit 60% reduction in lead time You never get Lean, 92% reduction in line move time with SIX SIGMA LEAN THINKING you only get Leaner
  • 78.
    Some Lean Successes HelicopterBCD Check: Reduced TAT from 28- 14 days Surveying Services: Exponentially increased flying hours for the photography aircraft. 10% increase in one week Wellhead Turnover: Days to turnover reduced Material Supply: Staging time reduced, scanners repaired, forklifts replaced. LEAN THINKING with SIX SIGMA
  • 79.
    Lean in ProjectMgt and Construction Studies involving international companies suggest a 25% improvement in construction productivity would be the low-hanging fruit. The main findings of the study are: 1. Avoidable Interruptions: Over 60% of workdays contain avoidable interruptions with a loss in man-hours of 10-40%. 2. Overtime : causes approximately 5% loss in productivity for every 5 hours of overtime per week. 3. Over-manning: 10% productivity loss for every 25% unplanned increase in labor force. 4. Days of Week: Productivity on Tuesdays, Wednesdays and Thursdays (Thursday/Friday/Sat in the West) can be 15% lower than that of the remaining part of the working week. 5. Productivity: can vary by up to 400% (from day to day) for same crew, and over 25% amongst crews performing similar activities under the same circumstances. Major causes of productivity variation are interruptions, quality of labor force, and motivation. Dr. Rashad Zakieh (PMP) Operations Services Saudi Aramco, Saudi Arabia Tel. 874-3800 (Work) LEAN THINKING with SIX SIGMA International email: rashadzakieh@hotmail.com
  • 80.
    BOEING 737 FINALASSEMBLY BEFORE LEAN IMPLEMENTATION LEAN THINKING with SIX SIGMA
  • 81.
  • 82.
    The Boeing 737Moving Line LEAN THINKING with SIX SIGMA
  • 83.
    LEAN AGENDA History Definition Goal Process Value StreamMapping Kaizen Becoming Lean Lean and Quality Metrics Why Lean Fails Resistance Six Sigma Your Responsibility How it ends Resources LEAN THINKING with SIX SIGMA
  • 84.
    SIX SIGMA It isa process capability measure It is a commercial program Packaged at Motorola in 1985 May lead to "Analysis Paralysis" LEAN THINKING with SIX SIGMA
  • 85.
    Lean Focus -The 8 Wastes Lean focuses on identifying and eliminating the 8 hidden wastes common to both manufacturing and service industries: 1. OVER-PROCESSING: Adding more value to a service or product than customers want or will pay for. 2. MOTION: Needless movement of people (looking for things). 3. TRANSPORTATION: Unnecessary movement of materials. 4. EXCESS INVENTORY: any work-in-process or raw material that is in excess of what is required to produce just-in-time for the customer. 5. WAITING: Any delay between when one process step/activity ends and the next step/activity begins. 6. DEFECTS: Any aspect of the product or service that does not conform to customer needs. (SIX SIGMA) Variation = defects 7. OVER-PRODUCTION: Production of service outputs or products beyond what is needed for immediate use. 8. UNUSED EMPLOYEE CREATIVITY: Losing time, ideas, skills, improvements, and learning opportunities by not engaging or listening to your employees. LEAN THINKING with SIX SIGMA
  • 86.
    Understanding Variation Variation means thata process or product does not produce the same results every time it is measured is always present at some level is inherent in every process or product is our enemy in delivering services or manufacturing products, reduction helps to improve quality, reduce costs, increase profits, and increase customer satisfaction. LEAN THINKING with SIX SIGMA
  • 87.
    Lean Six SigmaProcess Improvement Lean Six Sigma uses the DMAIC process for Project Management Project Execution LEAN THINKING with SIX SIGMA
  • 88.
    Dissecting DMAIC Define Measure Analyze Improve Control the process: the process gains: what is important to the customer?: Analyze Data Ensure Solution is Identify Root Causes Sustained Project Selection Team Formation Establish Goal the process performance measures: how well we are doing?: Prioritize root causes Collect Data Innovate pilot solutions Construct Process Flow Validate the improvement Validate Measurement System LEAN THINKING with SIX SIGMA
  • 89.
    Y = f(x) Y=f(x) , refers to a problem or process output (Y) , that is the result of one or more process inputs (Xs) . Eliminating or improving the Xs reduces or eliminates the problem (Y) . Controlling the Xs provides a process that is more - Predictable - Reliable - Capable - Repeatable, and - Dependable The results are a Y that can be forecast, and a proactive rather than reactive work environment. LEAN THINKING with SIX SIGMA
  • 90.
    Waste & ProcessVariation - The True Costs Scrap Inspection Rework Traditional Cost of Warranty Field Modifications Poor Quality (COPQ) Rejects (measured) Penalties & damages Hidden Cost of Lost sales Poor Quality (COPQ) times Long cycle Overtime Margin slippages (measurable) Late delivery More receivables Travel & Living Expenses Longer Set-ups Lost Opportunity Excess inventory Expediting costs Lengthy Installs (intangible) Customer Productivity Loss Sales compromises Engineering Change Orders Lost Customer Loyalty Customer Dissatisfaction Employee Morale, Productivity, Turnover LEAN THINKING with SIX SIGMA
  • 91.
    Understanding & ReducingVariation # of Goals Lower Specification Upper Specification Limit LEAN THINKING with SIX SIGMA Limit
  • 92.
    What Does SigmaLevel Mean? Example Lower Upper Specification Specification Limit (customer) Limit (customer) Customers have Target a target in mind, but will allow some variation within the Spec Range LEAN THINKING with SIX SIGMA
  • 93.
    What Does SigmaLevel Mean? Example Lower Upper Specification Specification Limit Target Limit Actual Measurement has Considerable Variation Defects Defects - Resulting in Scrap, Waste, Late Deliveries, and Customer Dissatisfaction LEAN THINKING with SIX SIGMA
  • 94.
    What Does SigmaLevel Mean? Lower Upper Specification Specification Target Limit Limit How Capable is our Process to Produce within Defects Defects Spec? Sigma Defects % Level Per Mill. In Spec. 2 308,500 69.1 On Average it's OK -it's a Variation issue On Average it's OK - it's a Variation issue LEAN THINKING with SIX SIGMA BEWARE OF AVERAGES
  • 95.
    What Does SigmaLevel Mean? Lower Upper Specification Specification Limit Limit Reducing Variation is Clearly the Key to Improving Process Capability Sigma Defects % Level Per Mill. In Spec. 3 66,800 93.3 LEAN THINKING with SIX SIGMA
  • 96.
    What Does SigmaLevel Mean? Causes of Variation Include Lower Upper Specification Specification a Variety of Limit Limit Factors, such as: 1. Machines 2. People 3. Material 4. Environment 5. No Standard Sigma Defects % Work. Level Per Mill. In Spec. 4 6,200 99.4 LEAN THINKING with SIX SIGMA
  • 97.
    What Does SigmaLevel Mean? Variation Causes Errors, which Lower Upper Cause Defects, Specification Specification Limit Limit which Lead to Rework, and to Processes which are not Stable Reliable, Repeatable, and Sigma Defects % Predictable. Level Per Mill. In Spec. 5 233 99.98 LEAN THINKING with SIX SIGMA
  • 98.
    What Does SigmaLevel Mean? Reducing Variation Lower Specification Upper Specification Reduces Errors, Limit Limit and the Resulting Defects and Rework, and therefore leads to Improved Process Sigma Defects % Capability Level Per Mill. In Spec. 6 3.4 99.9997 LEAN THINKING with SIX SIGMA
  • 99.
    Variation = UnpredictableProcesses Work Order Process Mean Improved Process Existing Process 1 50 100 Output Variation in weeks Contracting process Material Delivery process Time to sink a well Wife's shopping bill Wife's shopping time Customers Remember the Extremes (Variation), not the Average LEAN THINKING with SIX SIGMA
  • 100.
    ENTITLEMENT Improved Process Upper Mean Specification Entitlement Limit Existing Process 1 50 100 Output Variation in weeks LEAN THINKING with SIX SIGMA LSS Helps Us Consistently Deliver the Best We Can Do.
  • 101.
    What Does SigmaLevel Mean? sure Lower Mea y Upper Limit evel is a bilit Specification Specification Limit a L ss Capa Sigm roce of P Sigma Defects % Level Per Mill. In Spec. 2 308,500 69.1 3 66,800 93.3 4 6,200 99.4 5 233 99.98 LEAN THINKING with SIX SIGMA 6 3.4 99.9997
  • 102.
    Practical Meaning ofSix Sigma 3.8-Sigma 3.8-Sigma 6-Sigma 6-Sigma 3.4 defects per million 99% Good 99% Good 99.99966% Good 99.99966% Good opportunities 20,000 lost articles of mail per hour Seven articles lost per hour 5,000 incorrect surgical operations per 1.7 incorrect operations per week week Two short or long landings at most One short or long landing every five major airports each day years 200,000 wrong drug prescriptions each 68 wrong drug prescriptions per year year LEAN THINKING with SIX SIGMA
  • 103.
    Six Sigma ProjectManagement Checklist Define Define Measure Measure Analyze Analyze Improve Improve Control Control Identify Sponsor and other Create Fishbone Analyze Process Flow Develop solution options Perform Capability key stakeholders Tie to defined Critical Path Improve control of Analysis of improved Form project team defect Value-added significant root causes process Team leader Collect Data steps Re-design process to Develop and Implement Team members Ys (results) with Non value- obtain required a Control Plan Tour process Xs (data tags) added steps capability Complete Project Clarify project Evaluate Measurement Opportunities Perform DOE as Closure Package Problem statement Systems Analyze Data required Update financial Goal statement Gage R&R, Graphical tools Evaluate options and select benefits statement as Process output = Y Understand detailed Hypothesis final solution required Define process process Tests Prioritization matrix Get OCD focal boundaries Detailed process Interrelationship Determine measurement final evaluation High level map map w/ rework Digraph (if system for improved process List best practices (SIPOC) loops appropriate.) Create implementation plan Identify lessons Define project boundaries Describe Process Regression Update FMEA learned Resources Numerical analysis Update financial benefits Authority statistics Identify and collect statement Use SPC Charts Determine project timeline Graphs: Time, additional required data Contact Six Sigma Hand off project to Identify CTQ Customer Hist., Pareto, etc. Identify significant Xs OCD for concurrence process owner Requirements Create control Tie to root Obtain buy-in / support for Create follow up Define the Defect chart cause analysis improvement actions action plan Define defect Establish Process Draw Conduct pilot / testing to Develop Final report out measure Capability conclusions verify results Standard Develop estimate of DPMO or % Perform FMEA Implement improvements template potential financial benefit if Defects Update charter as Collect data to verify project goal is achieved Calculate Z required improvement Gain Sponsor Approval of Update Charter Develop Analyze Communicate results Project Charter as required report out Update Charter Identify Pull and Push Develop Define/Measure Standard as required Leveraging opportunities report out template Develop Improve report out Standard template For Sponsor Project Champion Master Black Belt
  • 104.
    LEAN AGENDA History Definition Goal Process Value Stream Mapping Kaizen Becoming Lean Lean and Quality Metrics Why Lean Fails Resistance Six Sigma Your Responsibility How it ends Resources LEAN THINKING with SIX SIGMA
  • 105.
    You Turn theGears # of Teams Chartered Value Stream # of Events Penetration ultiple Passes Full-Time Resources Discipline to the Process Results Critical Mass Internal Experts Self-sustaining Lean Culture DEPLOYMENT METRICS LEAN THINKING with SIX SIGMA
  • 106.
    Leadership's Role Senior Leadership 1. Create the Vision - Where are we going and why are we going there? 2. Align the Organization - Goals and Objectives - One Plan - One Initiative 3. Participate in the Process - Don't just "talk it" , WALK IT 4. Commit Resources - Right quantity and caliber 5. Educate the Workforce 6. Communicate - Vision, Results, Lessons Learned LEAN THINKING with SIX SIGMA
  • 107.
    Leadership's Role The Manager'sRole 1. Help pick the right value streams, projects and teams 2. Follow the method Remove barriers to change Have one plan 3. Clearly define roles and responsibilities 4. Support the Education & Training of your employees 5. Communicate Engage the workforce in dialogue about Lean. Walk the walk, talk the talk. Host and participate in continuous process improvement activities. Be a cheerleader. Emphasize quality, 5S, identification and elimination of waste. Demand follow-up and sustained improvement. LEAN THINKING with SIX SIGMA
  • 108.
    LEAN AGENDA History Definition Goal Process Value Stream Mapping Kaizen Becoming Lean Lean and Quality Metrics Why Lean Fails Resistance Six Sigma Your Responsibility How it ends Resources LEAN THINKING with SIX SIGMA
  • 109.
    The Results REMEMBER: It is CONTINUOUS Process Improvement COST, QUALITY , DELIVERY , SAFETY , MORALE Lean Increases Capacity - Your process can produce the same amount with fewer people. - Your process can produce more with the same number of people. No more band aid solutions that become tomorrow's problems. You come much closer to solving your process problems for the last time In a process with - Continuous Flow - Based on Takt Time - in a Pull Environment LEAN THINKING with SIX SIGMA
  • 110.
    Lean or SixSigma Goal: Breakthrough Performance Focused on things that matter Current State Process Lean or Six Sigma Breakthrough Defect s, cost, l time, waste Improvement Period Future State Process Time LEAN THINKING with SIX SIGMA
  • 111.
    LEAN AGENDA History Definition Goal Process Value Stream Mapping Kaizen Becoming Lean Lean and Quality Metrics Why Lean Fails Resistance Six Sigma Your Responsibility How it ends Resources LEAN THINKING with SIX SIGMA
  • 112.
    Reading List Lean Thinking TheMachine That Changed the World Better Thinking, Better Results Gemba Kaizen High Velocity Culture Change Learning to See 5 Pillars of the Visual Workplace The Goal Critical Chain The Gold Mine THINKING with SIX SIGMA LEAN
  • 113.
    WEBSITES - www.productivityinc.com - www.productivitypress.com - www.qualitypress.asq.org - www.sme.org - www.asq.org - www.crcpress.com - www.lean.org - www.nwlean.net - www.pmi.org - www.qualitydigest.com - www.isixsigma.com LEAN THINKING with SIX SIGMA
  • 114.
    LEAN AGENDA History Definition Goal Process Value StreamMapping Kaizen Becoming Lean Lean and Quality Metrics Why Lean Fails Resistance Six Sigma Your Responsibility How it ends Resources LEAN THINKING with SIX SIGMA
  • 115.
