Does the Project Manager Stand a
            Chance?

            Peter Langley
Value Management Specific Interest Group

        peter.langley@hotmail.co.uk

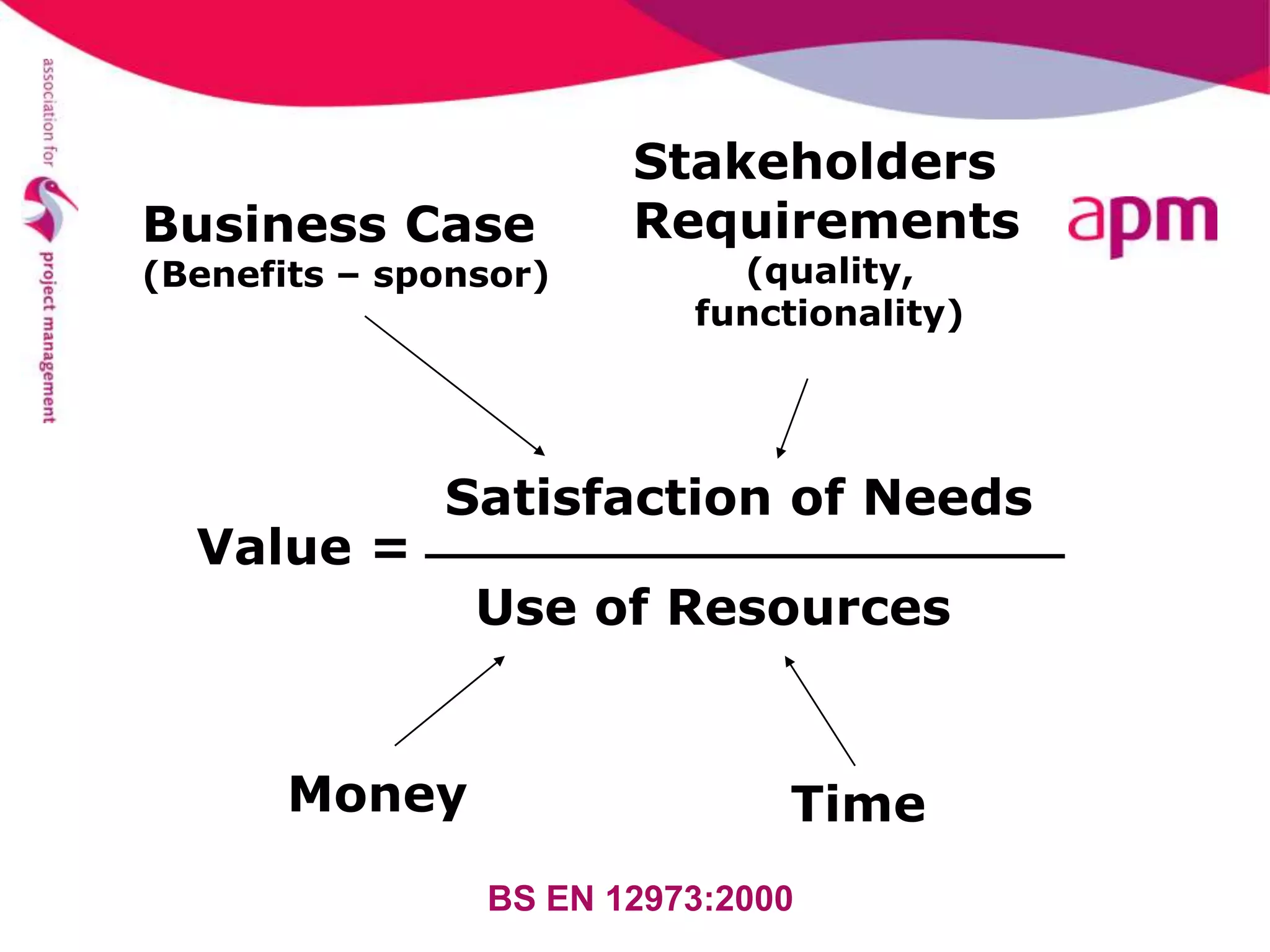

Stakeholders
Business Case          Requirements
(Benefits – sponsor)        (quality,
                          functionality)




              Satisfaction of Needs
  Value =
                Use of Resources


       Money                   Time
                BS EN 12973:2000

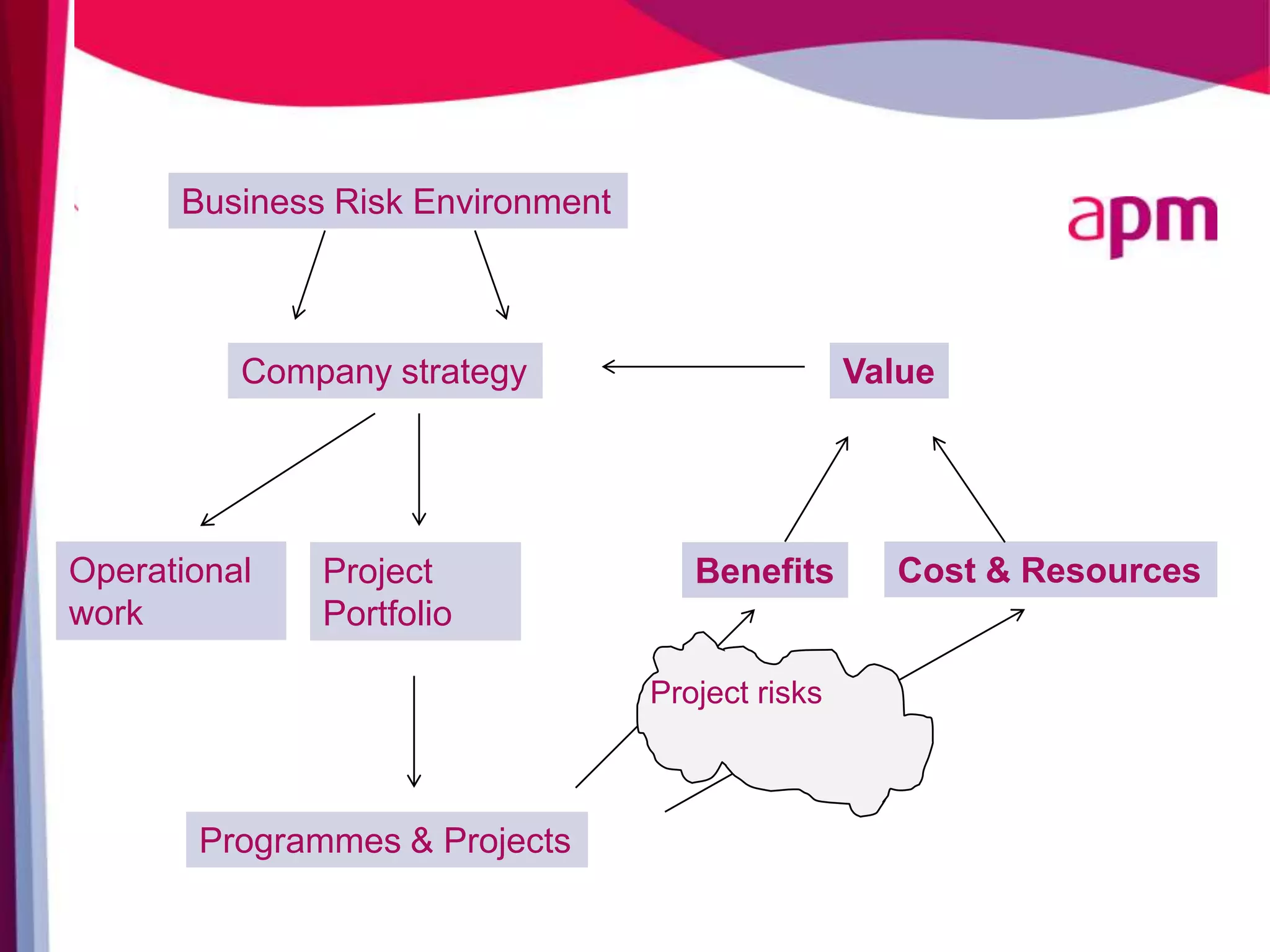

Business Risk Environment



          Company strategy                        Value




Operational   Project                Benefits       Cost & Resources
work          Portfolio

                                  Project risks



       Programmes & Projects

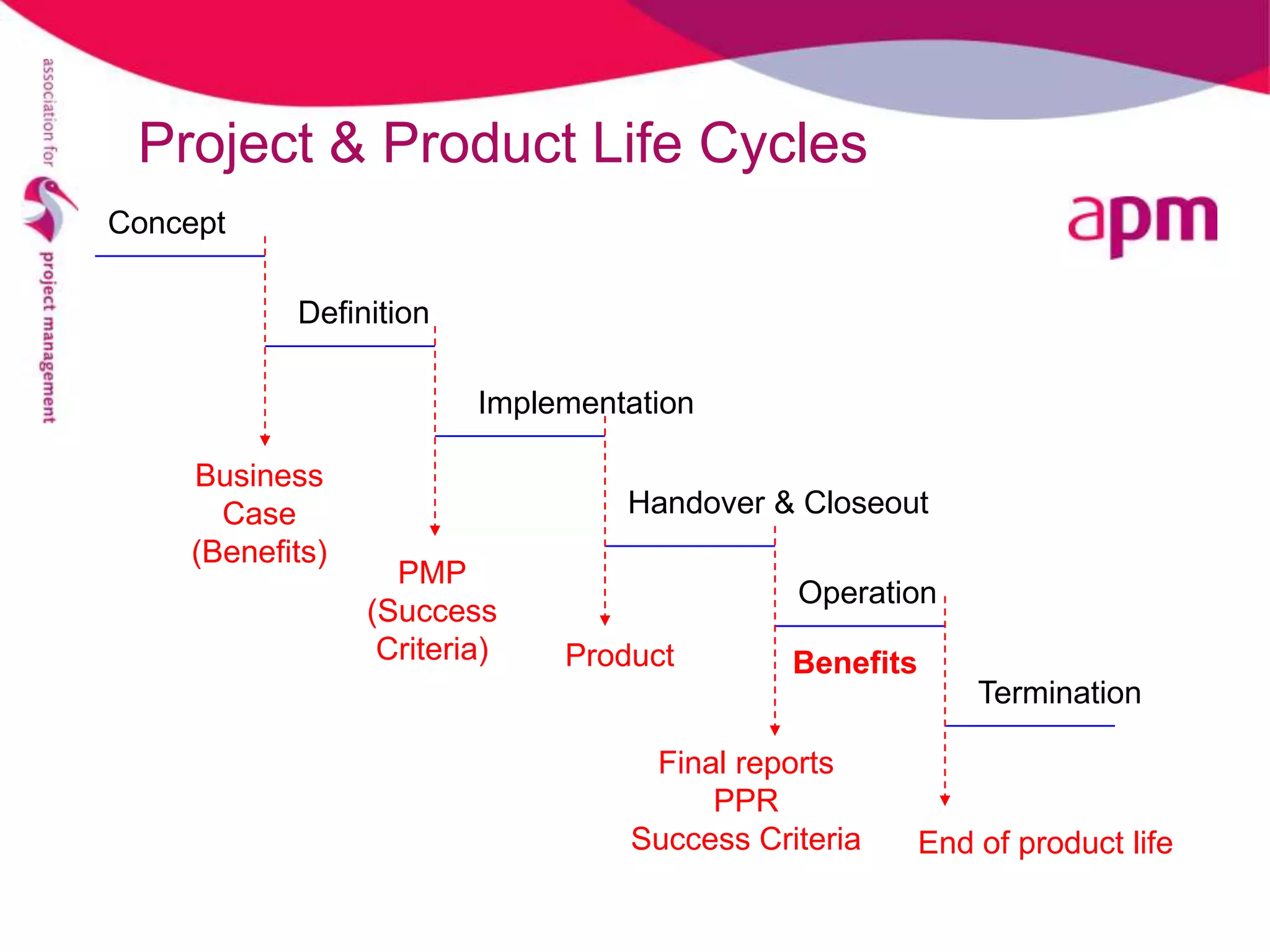

Project & Product Life Cycles
Concept

           Definition

                         Implementation

    Business
      Case                        Handover & Closeout
    (Benefits)
                   PMP
                                             Operation
                 (Success
                  Criteria)   Product        Benefits
                                                            Termination

                                   Final reports
                                       PPR
                                  Success Criteria      End of product life
Common Causes of Project Failure
     NAO/ OGC (2005)
   1. Lack of clear link to strategy
   2. Lack of senior management ownership
   3. Lack of stakeholder engagement
   4. Lack of PM skills
   5. Lack of breaking into manageable steps
   6. Evaluation driven by initial price not value
   7. Lack of contact with suppliers
   8. Lack of wider team/supplier integration

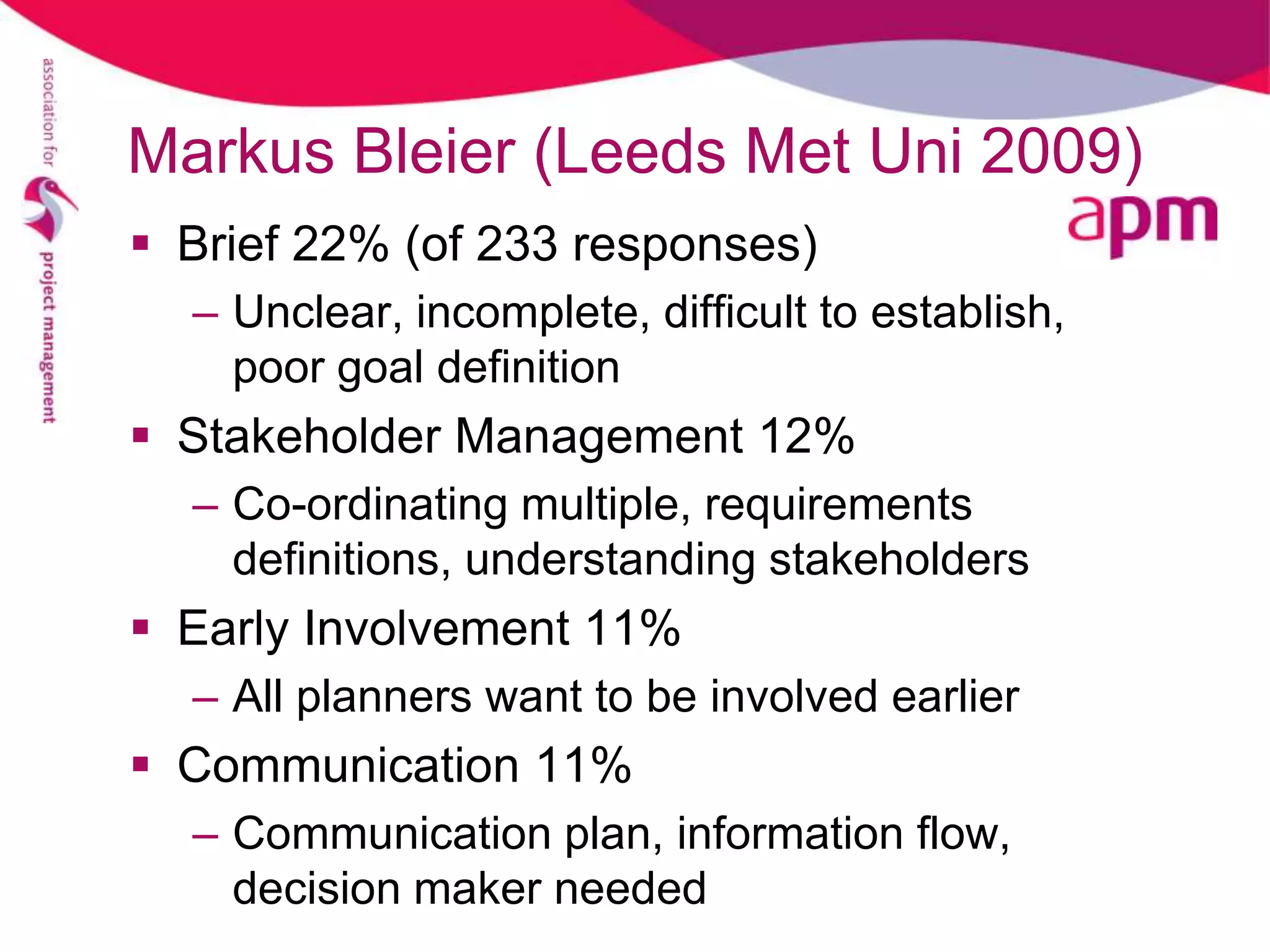

Markus Bleier (Leeds Met Uni 2009)
 Brief 22% (of 233 responses)
  – Unclear, incomplete, difficult to establish,
    poor goal definition
 Stakeholder Management 12%
  – Co-ordinating multiple, requirements
    definitions, understanding stakeholders
 Early Involvement 11%
  – All planners want to be involved earlier
 Communication 11%
  – Communication plan, information flow,
    decision maker needed

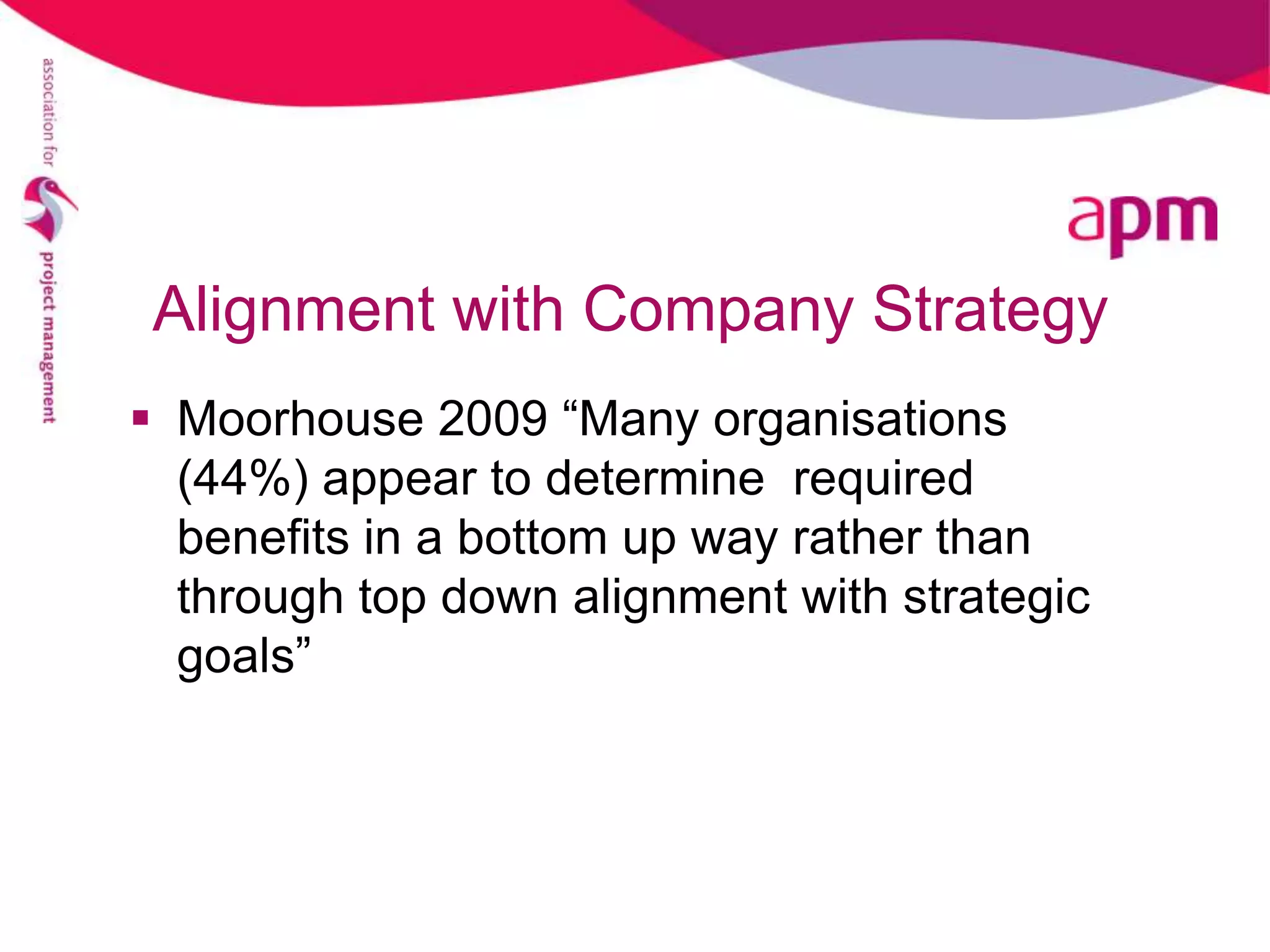

Alignment with Company Strategy
 Moorhouse 2009 “Many organisations
  (44%) appear to determine required
  benefits in a bottom up way rather than
  through top down alignment with strategic
  goals”
Delusions of Success
Dan Lovallo and Daniel Kahneman (2003)
 Issue of human cognition
 Managers make decisions based on
  delusional optimism
  –   Over-estimate benefits
  –   Under-estimate costs
  –   Spin scenario’s of success
  –   Overlook potential risks

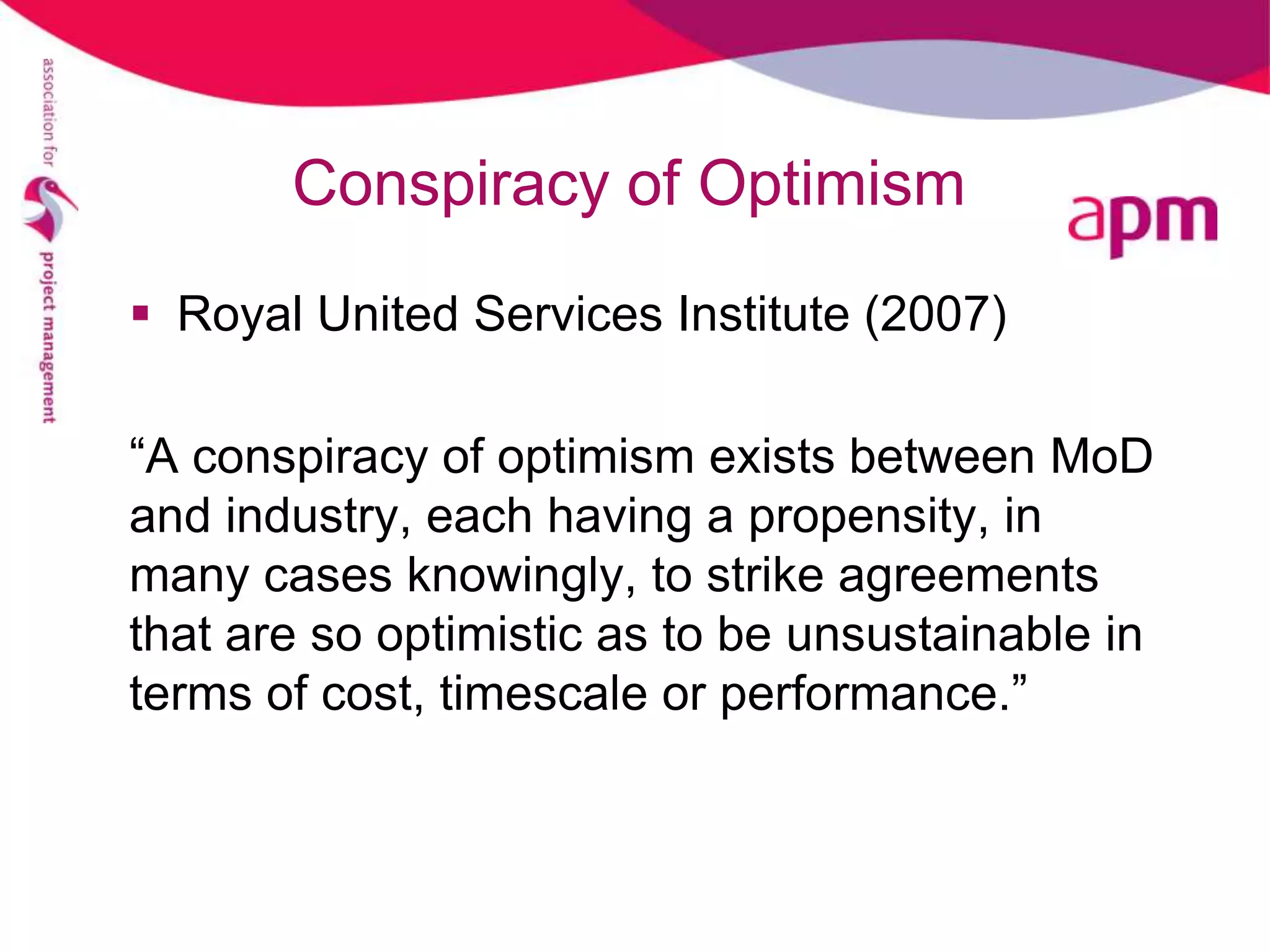

Conspiracy of Optimism
 Royal United Services Institute (2007)

“A conspiracy of optimism exists between MoD
and industry, each having a propensity, in
many cases knowingly, to strike agreements
that are so optimistic as to be unsustainable in
terms of cost, timescale or performance.”

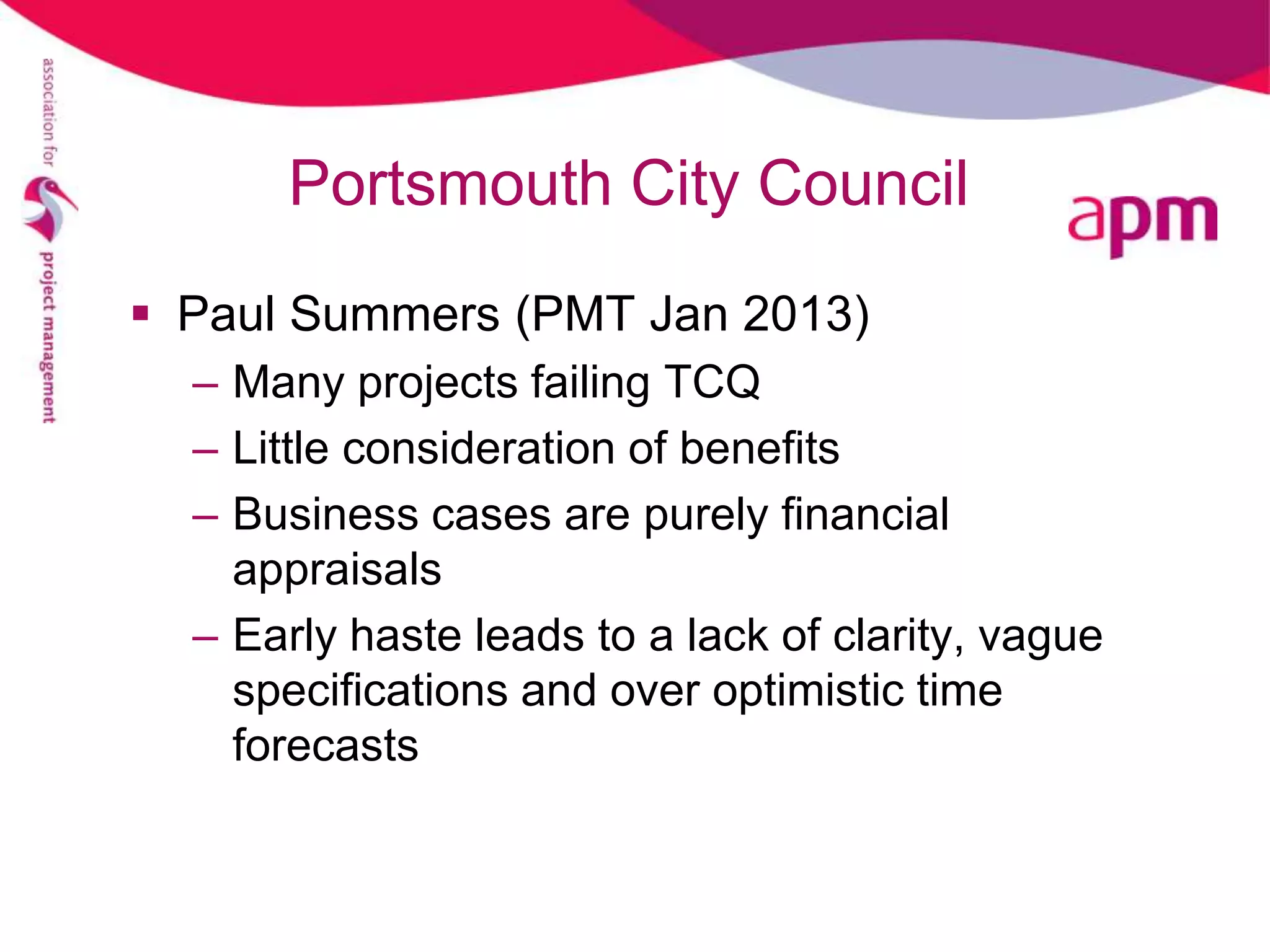

Portsmouth City Council
 Paul Summers (PMT Jan 2013)
  – Many projects failing TCQ
  – Little consideration of benefits
  – Business cases are purely financial
    appraisals
  – Early haste leads to a lack of clarity, vague
    specifications and over optimistic time
    forecasts

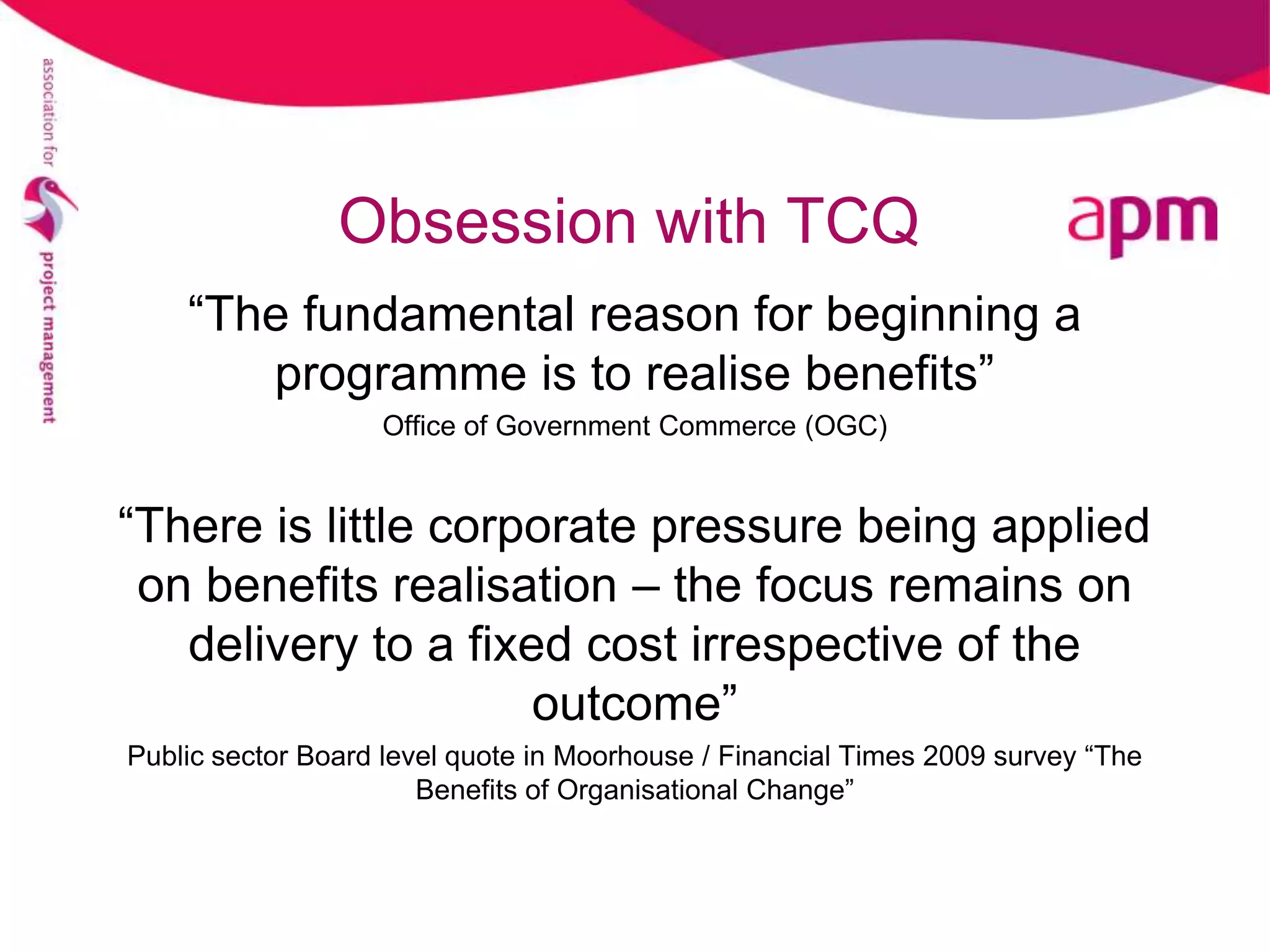

Obsession with TCQ
    “The fundamental reason for beginning a
       programme is to realise benefits”
                   Office of Government Commerce (OGC)


“There is little corporate pressure being applied
 on benefits realisation – the focus remains on
   delivery to a fixed cost irrespective of the
                     outcome”
Public sector Board level quote in Moorhouse / Financial Times 2009 survey “The
                       Benefits of Organisational Change”
Benefits Un-realisation
 “The project focus is on creating the business
  case to get the budget approved, then emphasis
  is on delivery on time and to budget”
 “Benefits identification is treated as a mechanism
  to get funding, but there is no effort in the
  realisation of these benefits”
 “Many gateway reviewers don’t understand
  benefits so this is an area that is glossed over”
          Active Benefits Realisation Survey – Steve Jenner 2009

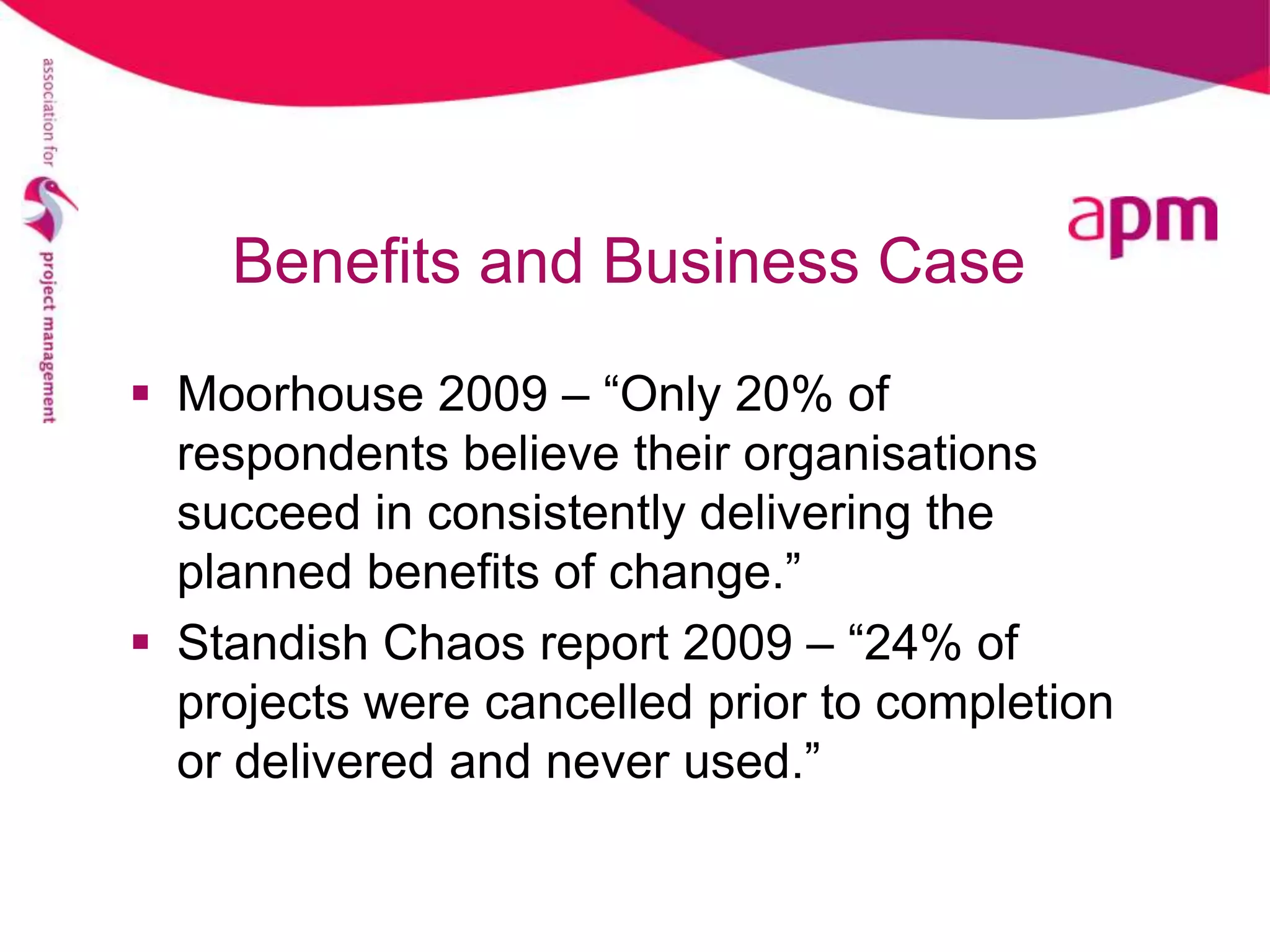

Benefits and Business Case

 Moorhouse 2009 – “Only 20% of
  respondents believe their organisations
  succeed in consistently delivering the
  planned benefits of change.”
 Standish Chaos report 2009 – “24% of
  projects were cancelled prior to completion
  or delivered and never used.”
Problems with Business Cases
 Moorhouse 2009 “Business cases are
  normally used but only as a paper
  exercise, they have very little substance.
  Dashboards are skewed to demonstrate
  success rather than used to drive
  improvement” Executive, Telecoms

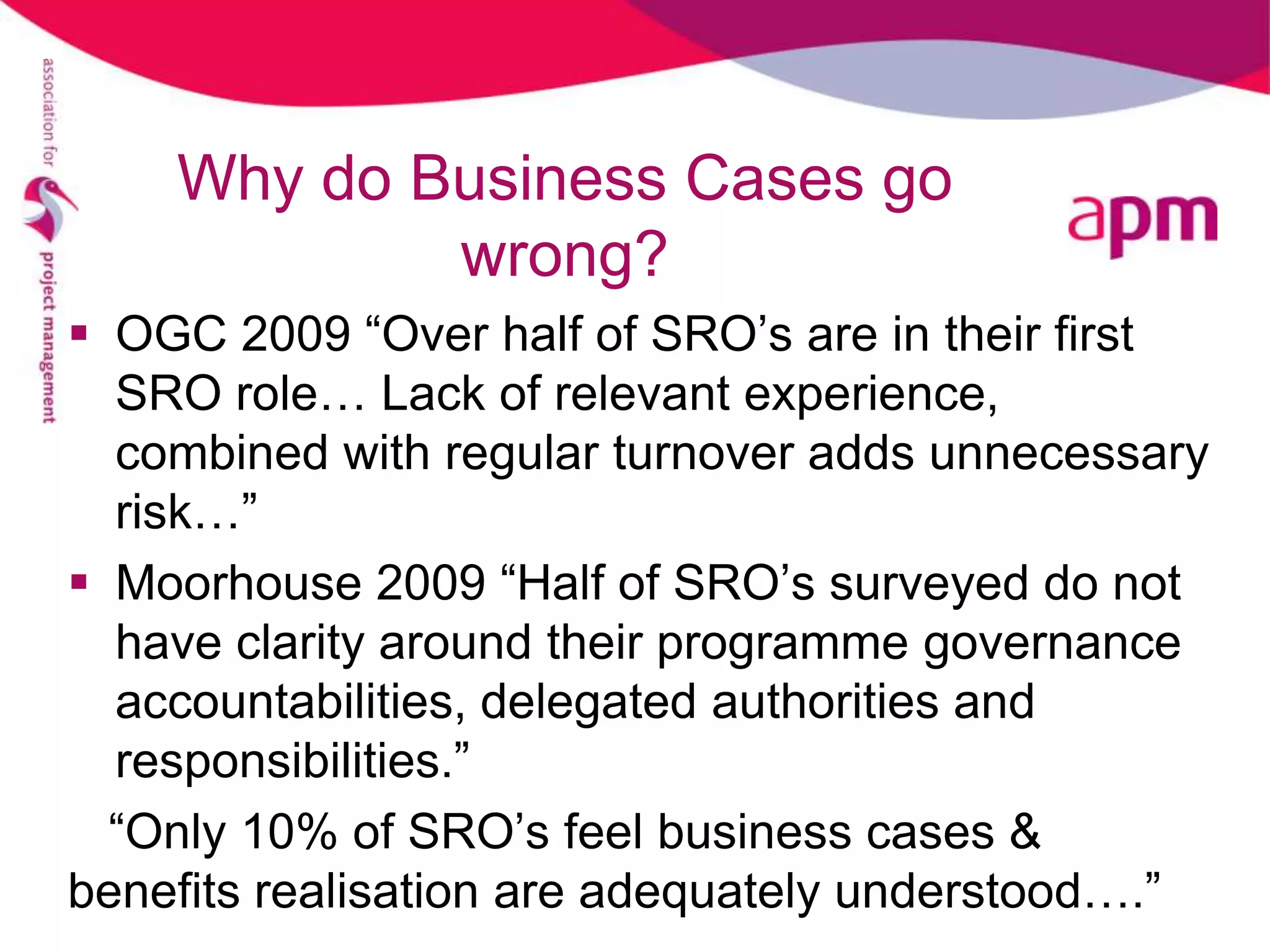

Why do Business Cases go
            wrong?
 OGC 2009 “Over half of SRO’s are in their first
  SRO role… Lack of relevant experience,
  combined with regular turnover adds unnecessary
  risk…”
 Moorhouse 2009 “Half of SRO’s surveyed do not
  have clarity around their programme governance
  accountabilities, delegated authorities and
  responsibilities.”
  “Only 10% of SRO’s feel business cases &
benefits realisation are adequately understood….”

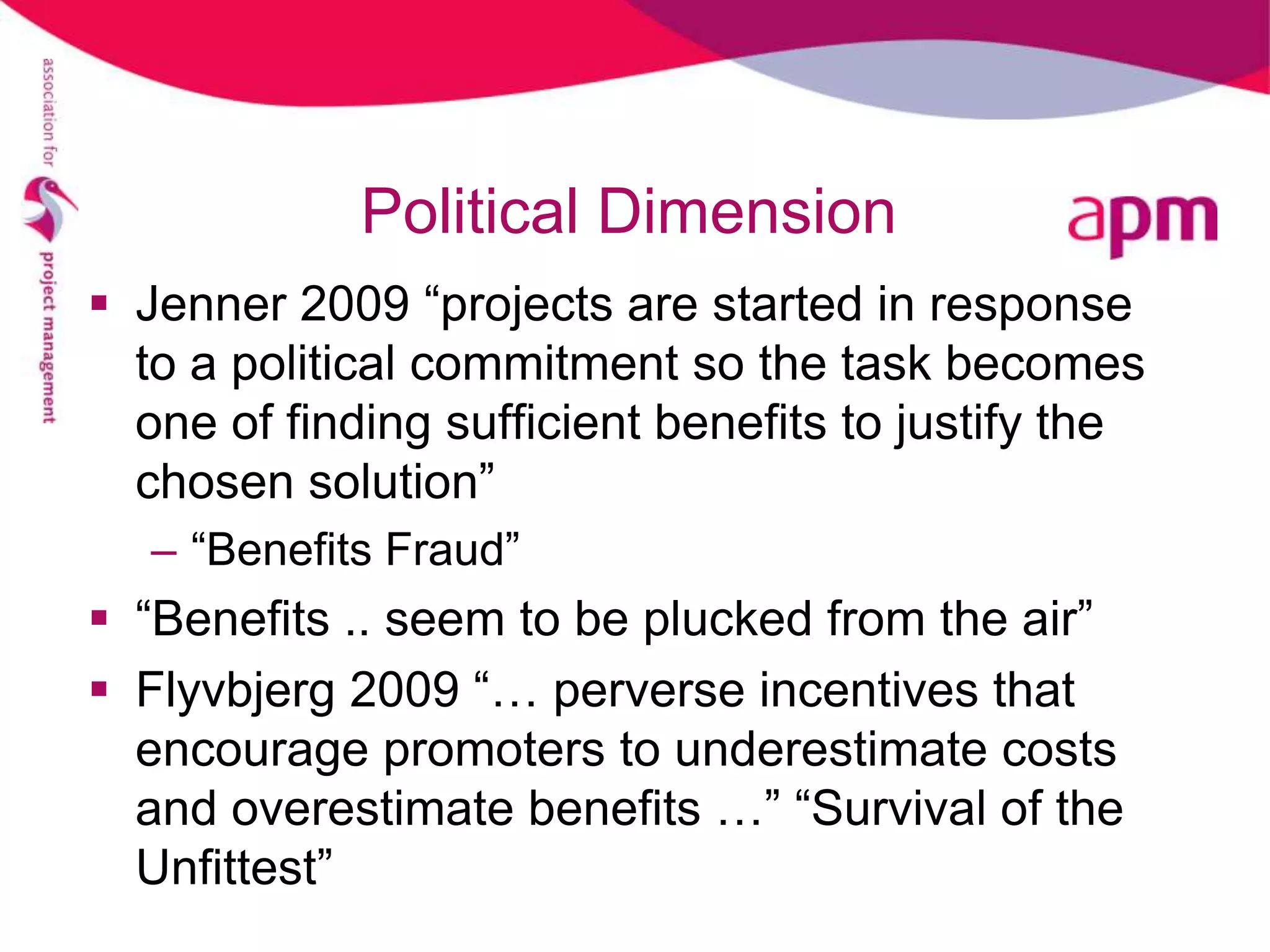

Political Dimension
 Jenner 2009 “projects are started in response
  to a political commitment so the task becomes
  one of finding sufficient benefits to justify the
  chosen solution”
   – “Benefits Fraud”
 “Benefits .. seem to be plucked from the air”
 Flyvbjerg 2009 “… perverse incentives that
  encourage promoters to underestimate costs
  and overestimate benefits …” “Survival of the
  Unfittest”
Norwegian research
    Analysis of 25 major public investment projects
   16 Alternative concepts not scrutinised
   14 Lack of realistic objectives & justification
   14 Not relevant in relation to needs or market
   10 Tactical under estimation of costs
    9 Perverse incentives – benefits without liability
    7 Tactical splitting & sequencing of project
    6 Tactical over estimation of needs & benefits
    6 Under estimation of future operational costs
               Knut Samset 2008 www.concept.ntnu.no
Your Turn!!
 What are your experiences in the early
  phases of a project?

 Do you have any ideas for a way forward?

 Do you have any proposals for research
  subjects?

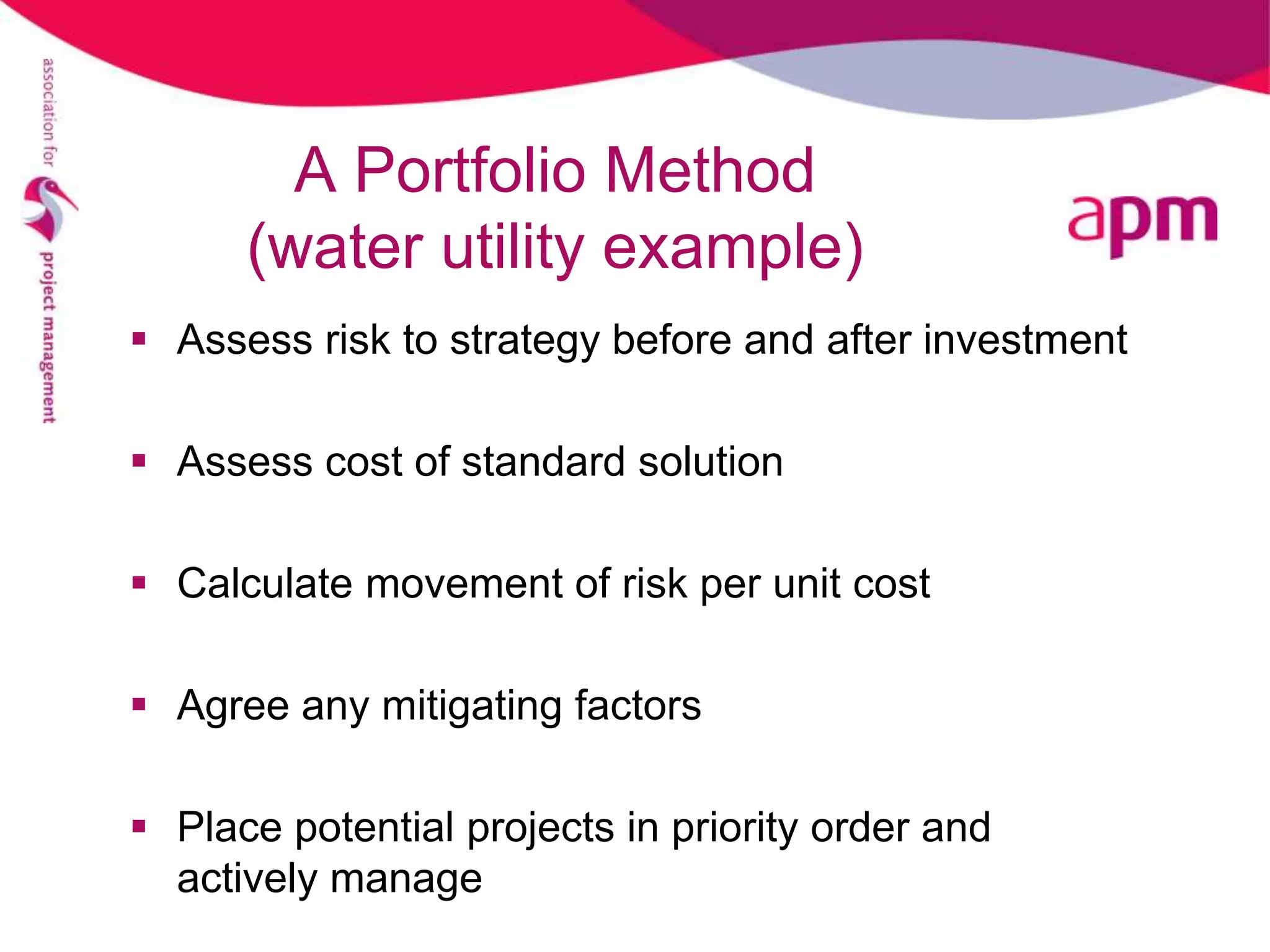

A Portfolio Method
      (water utility example)
 Assess risk to strategy before and after investment

 Assess cost of standard solution

 Calculate movement of risk per unit cost

 Agree any mitigating factors

 Place potential projects in priority order and
  actively manage
Final word – Tim Banfield -NAO
            (2012)
 It has become very clear that the quality of
  project initiation is highly predictive of
  project success.
 Our hero’s should be the people who start
  projects right!
Thank you


Any Questions or Comments?
Next Steps - Ideas so far
 Research into Concept phase of projects to prove
  case for action
 Encourage better use of Value, Risk and Benefits
  Management at all levels in business within
  context of good governance
 Joint SIG events (e.g. governance, benefits, programme, risk)
 Engaging corporate members of APM
 Organisational maturity models to provide
  evidence of performance

Does the project manager stand a chance?
