Project Management
Final Project Report
For Construction of a House
By: Sanket Senapati
Roll No. 16202284
Purpose of the Project
The purpose of this project was to analyze project in the light of
terms of managing project explained by lectures and PMBOK.

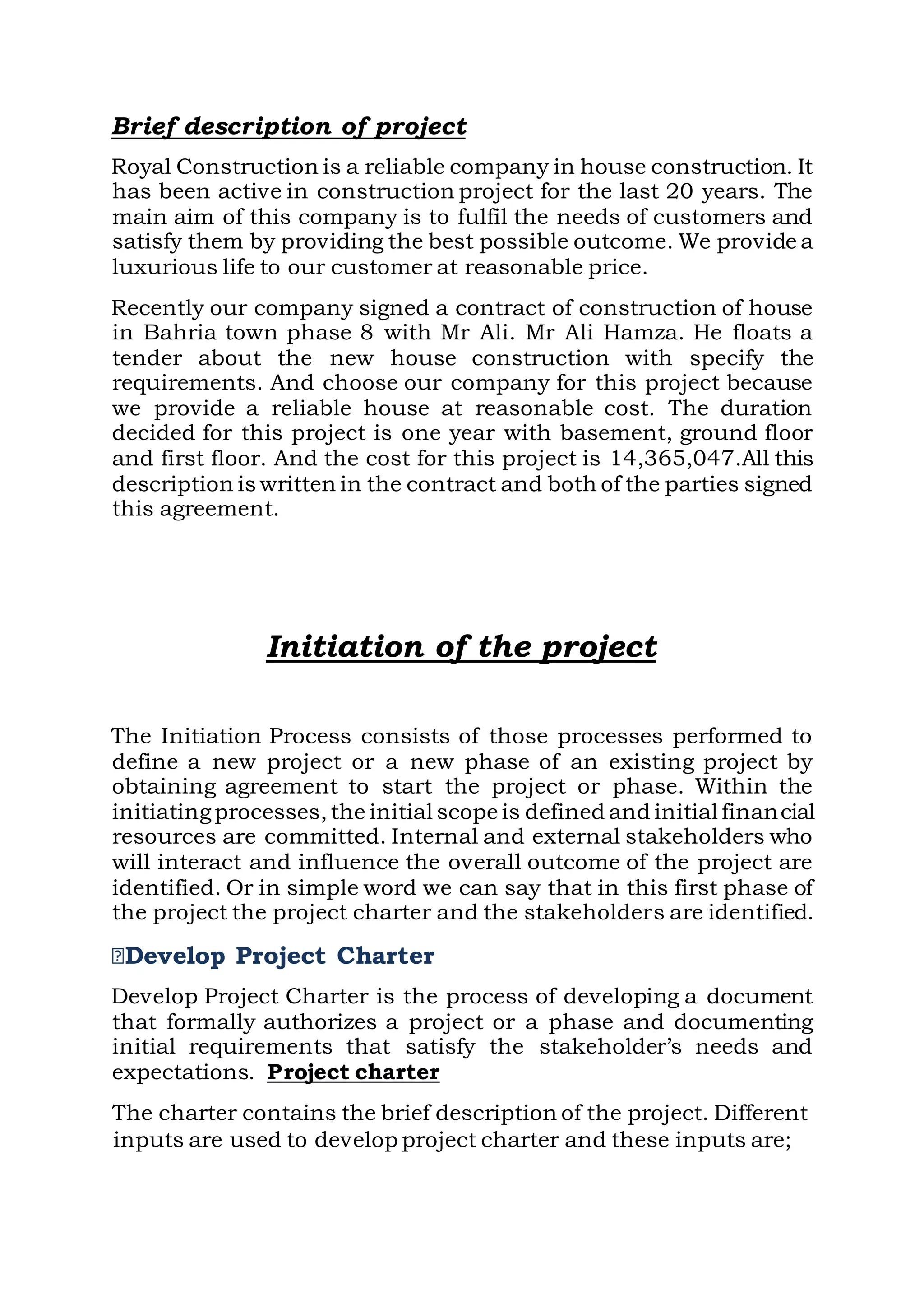

Brief description of project
Royal Construction is a reliable company in house construction. It
has been active in construction project for the last 20 years. The
main aim of this company is to fulfil the needs of customers and
satisfy them by providing the best possible outcome. We provide a
luxurious life to our customer at reasonable price.
Recently our company signed a contract of construction of house
in Bahria town phase 8 with Mr Ali. Mr Ali Hamza. He floats a
tender about the new house construction with specify the
requirements. And choose our company for this project because
we provide a reliable house at reasonable cost. The duration
decided for this project is one year with basement, ground floor
and first floor. And the cost for this project is 14,365,047.All this
description is written in the contract and both of the parties signed
this agreement.
Initiation of the project
The Initiation Process consists of those processes performed to
define a new project or a new phase of an existing project by
obtaining agreement to start the project or phase. Within the
initiatingprocesses, the initial scope is defined and initial financial
resources are committed. Internal and external stakeholders who
will interact and influence the overall outcome of the project are
identified. Or in simple word we can say that in this first phase of
the project the project charter and the stakeholders are identified.
Develop Project Charter
Develop Project Charter is the process of developing a document
that formally authorizes a project or a phase and documenting
initial requirements that satisfy the stakeholder’s needs and
expectations. Project charter
The charter contains the brief description of the project. Different
inputs are used to develop project charter and these inputs are;
Inputs

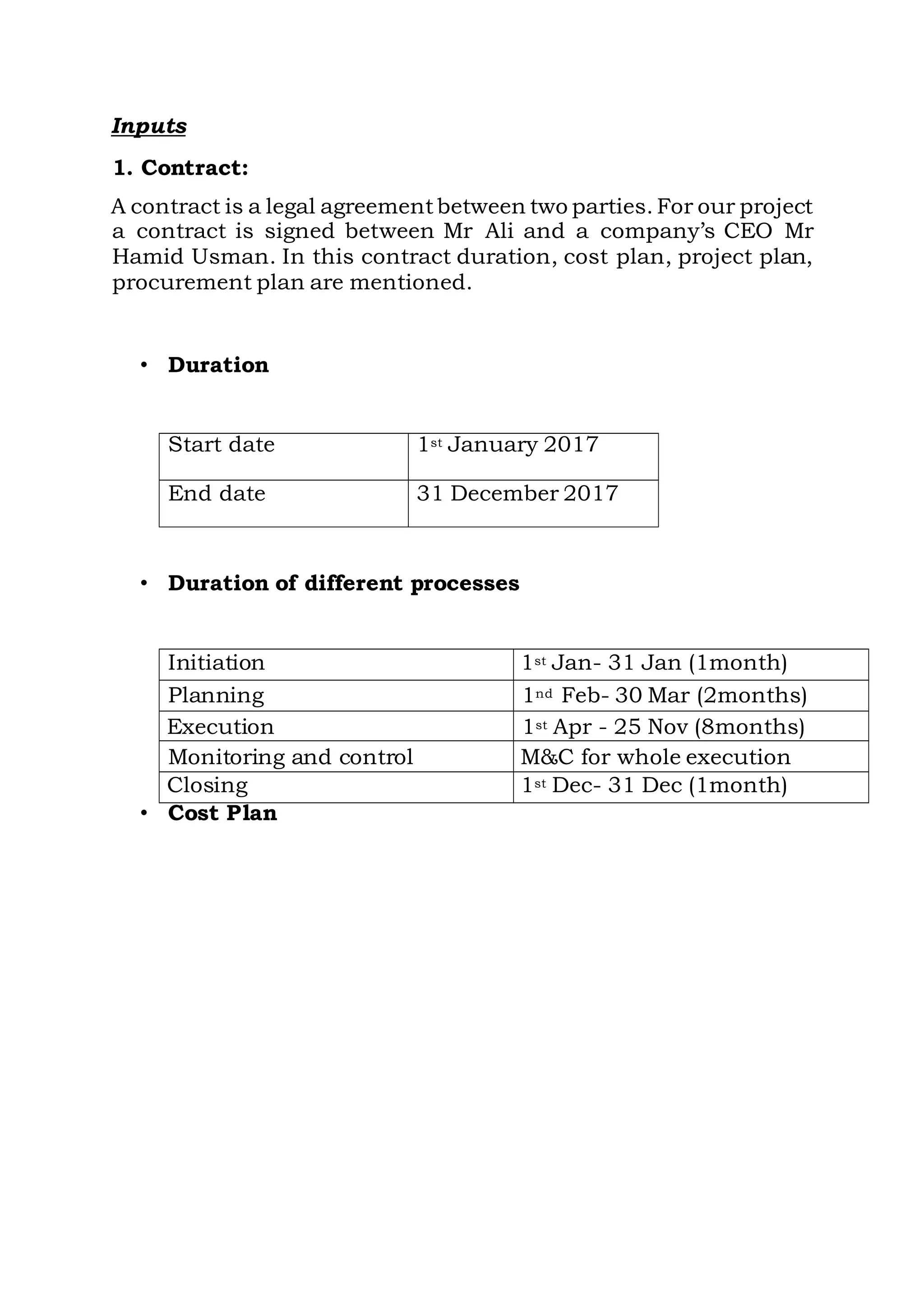

1. Contract:
A contract is a legal agreementbetween two parties. For our project
a contract is signed between Mr Ali and a company’s CEO Mr
Hamid Usman. In this contract duration, cost plan, project plan,
procurement plan are mentioned.
• Duration
Start date 1st January 2017
End date 31 December 2017
• Duration of different processes
Initiation 1st Jan- 31 Jan (1month)
Planning 1nd Feb- 30 Mar (2months)
Execution 1st Apr - 25 Nov (8months)
Monitoring and control M&C for whole execution
Closing 1st Dec- 31 Dec (1month)

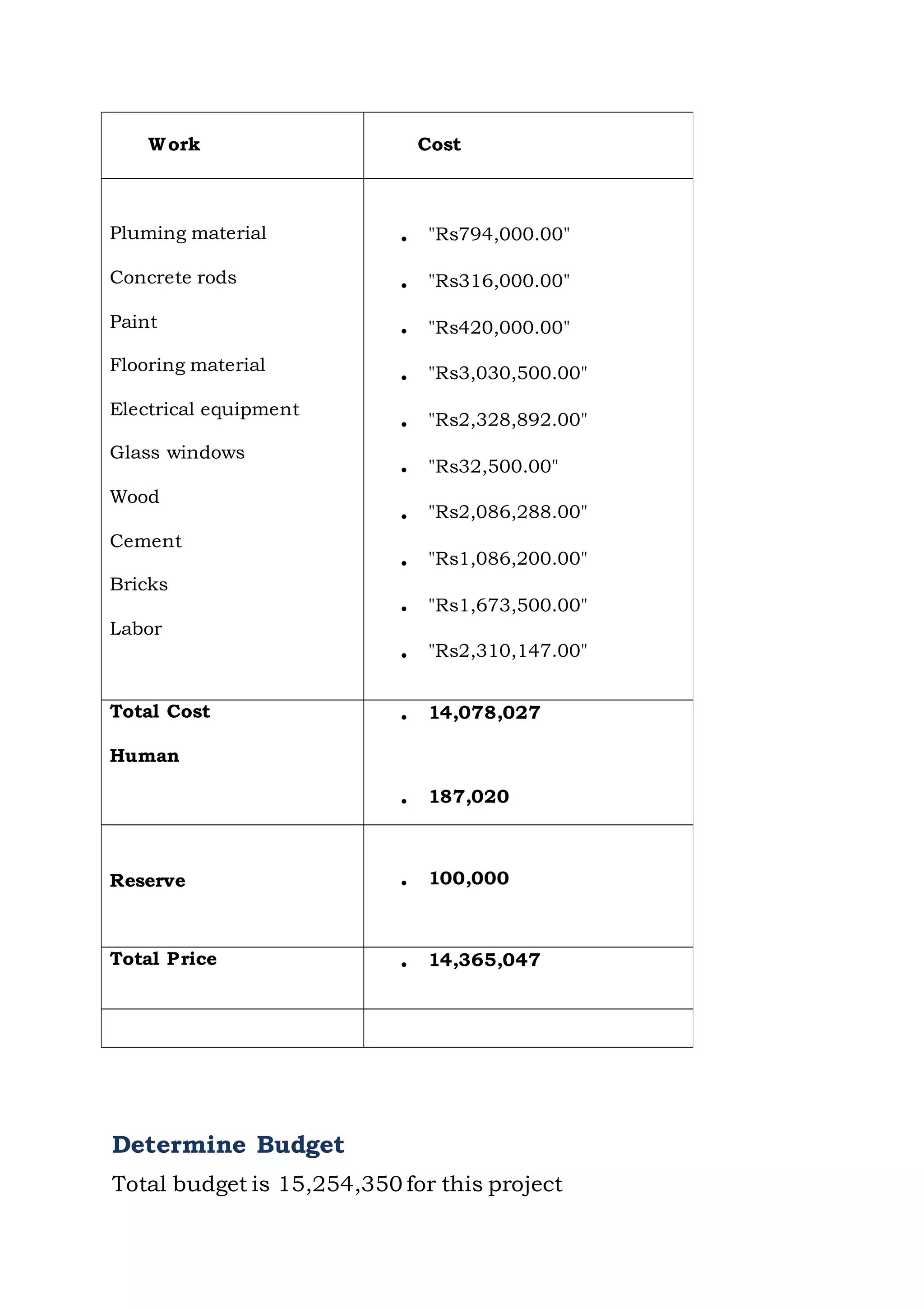

• Cost Plan

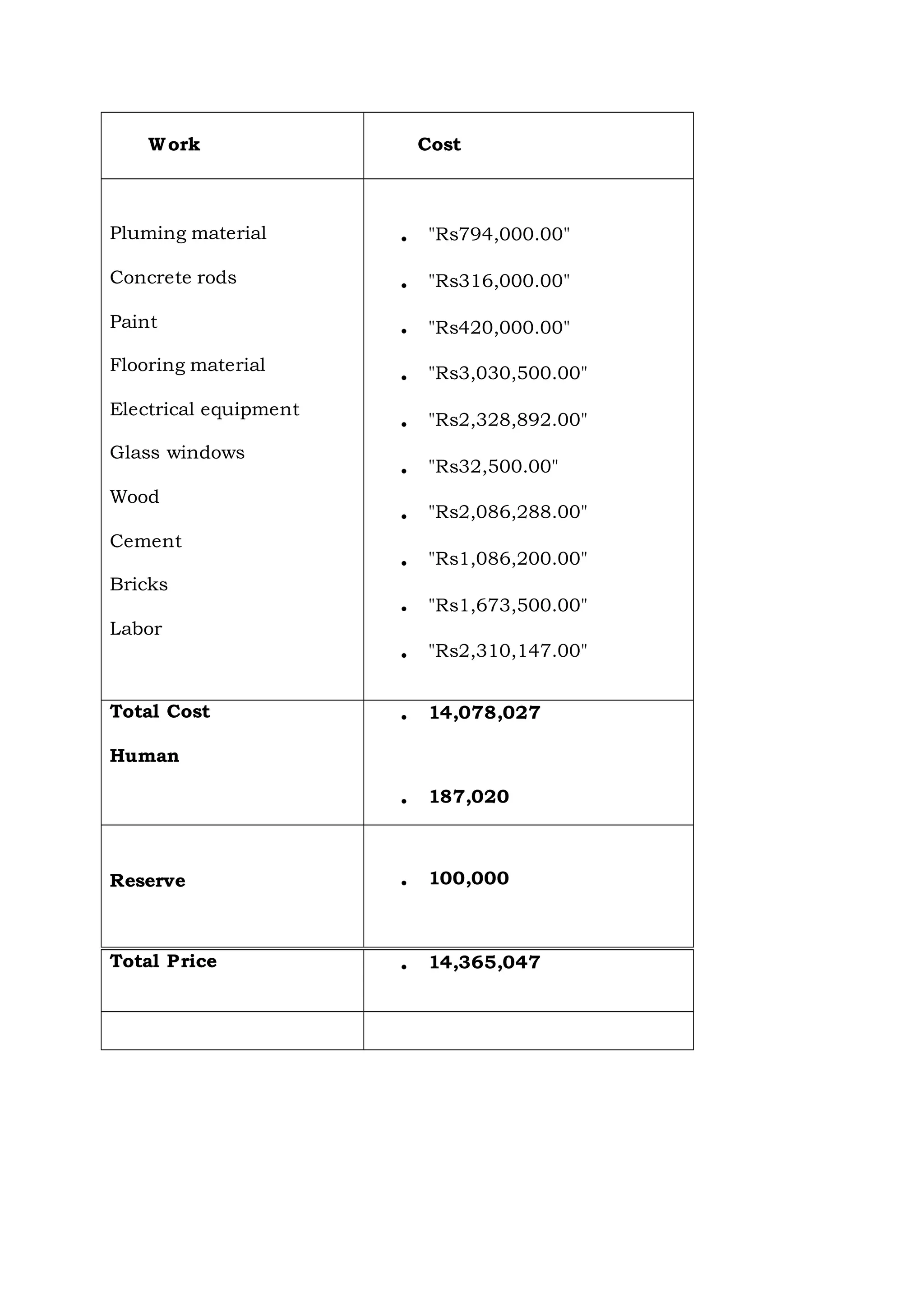

Work Cost
Pluming material
Concrete rods
Paint
Flooring material
Electrical equipment
Glass windows
Wood
Cement
Bricks
Labor
• "Rs794,000.00"
• "Rs316,000.00"
• "Rs420,000.00"
• "Rs3,030,500.00"
• "Rs2,328,892.00"
• "Rs32,500.00"
• "Rs2,086,288.00"
• "Rs1,086,200.00"
• "Rs1,673,500.00"
• "Rs2,310,147.00"
Total Cost
Human
• 14,078,027
• 187,020
Reserve • 100,000
Total Price • 14,365,047

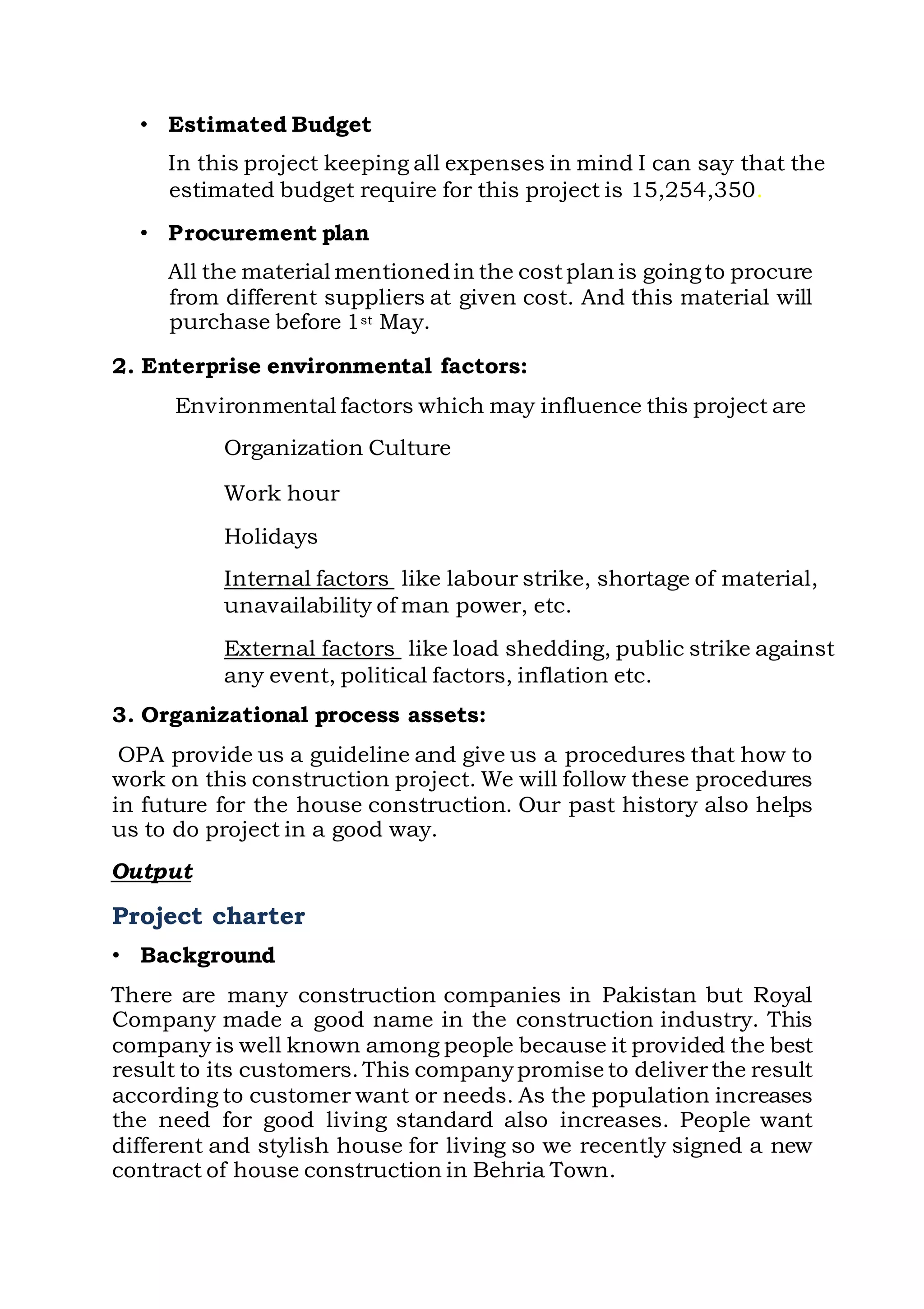

• Estimated Budget
In this project keeping all expenses in mind I can say that the
estimated budget require for this project is 15,254,350.
• Procurement plan
All the material mentionedin the costplan is goingto procure
from different suppliers at given cost. And this material will
purchase before 1st May.
2. Enterprise environmental factors:
Environmental factors which may influence this project are
Organization Culture
Work hour
Holidays
Internal factors like labour strike, shortage of material,
unavailability of man power, etc.
External factors like load shedding, public strike against
any event, political factors, inflation etc.
3. Organizational process assets:
OPA provide us a guideline and give us a procedures that how to
work on this construction project. We will follow these procedures
in future for the house construction. Our past history also helps
us to do project in a good way.
Output
Project charter
• Background
There are many construction companies in Pakistan but Royal
Company made a good name in the construction industry. This
company is well known among people because it provided the best
result to its customers. This companypromise to deliverthe result
according to customer want or needs. As the population increases
the need for good living standard also increases. People want
different and stylish house for living so we recently signed a new
contract of house construction in Behria Town.

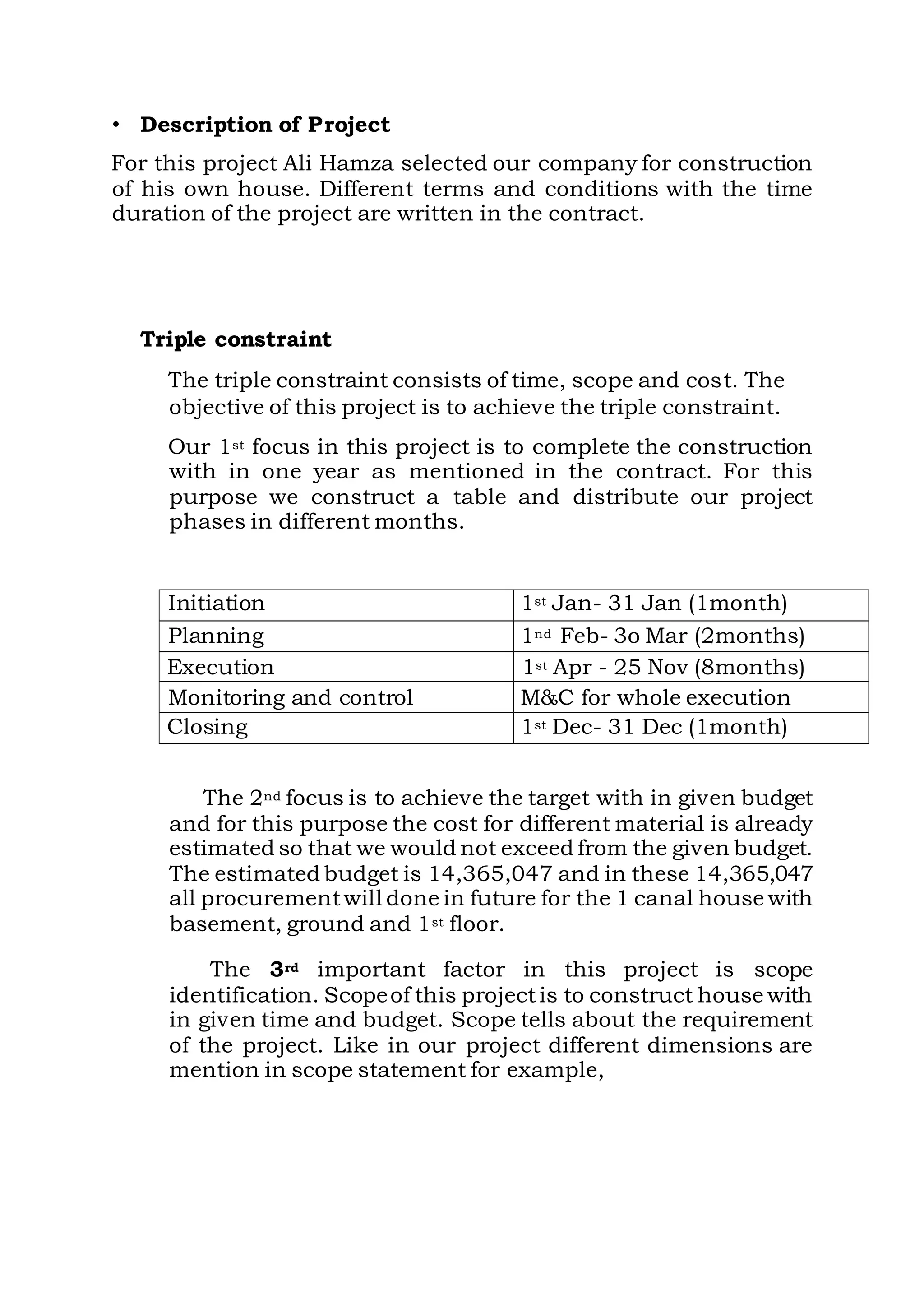

• Description of Project
For this project Ali Hamza selected our company for construction
of his own house. Different terms and conditions with the time
duration of the project are written in the contract.
Triple constraint
The triple constraint consists of time, scope and cost. The
objective of this project is to achieve the triple constraint.
Our 1st focus in this project is to complete the construction
with in one year as mentioned in the contract. For this
purpose we construct a table and distribute our project
phases in different months.
Initiation 1st Jan- 31 Jan (1month)
Planning 1nd Feb- 3o Mar (2months)
Execution 1st Apr - 25 Nov (8months)
Monitoring and control M&C for whole execution
Closing 1st Dec- 31 Dec (1month)
The 2nd focus is to achieve the target with in given budget
and for this purpose the cost for different material is already
estimated so that we would not exceed from the given budget.
The estimated budget is 14,365,047 and in these 14,365,047
all procurementwill done in future for the 1 canal house with
basement, ground and 1st floor.
The 3rd important factor in this project is scope
identification. Scopeof this projectis to construct house with
in given time and budget. Scope tells about the requirement
of the project. Like in our project different dimensions are
mention in scope statement for example,
Other than this information the time taken to complete these
is also mention in the scope statement. We will try to not
exceed from our scope and finishing the project with in the
time and costing limit.
• Project Team
Project team is also made for this project and these are
1. Project Manager
Mr. Rudra Pratap
Mr. Manoj Kumar
2. Team Leader
Mr. Dusmanta Singh
3. Team Members
Mr. Sujit
Mr. Biki
Mr. Rana
Mrs. Asima Khan
Miss. Sabita Malik
4. Assistants
Mr. Bikash Patel
Mr. Priyaranjan Panda
Mrs. Jayashree

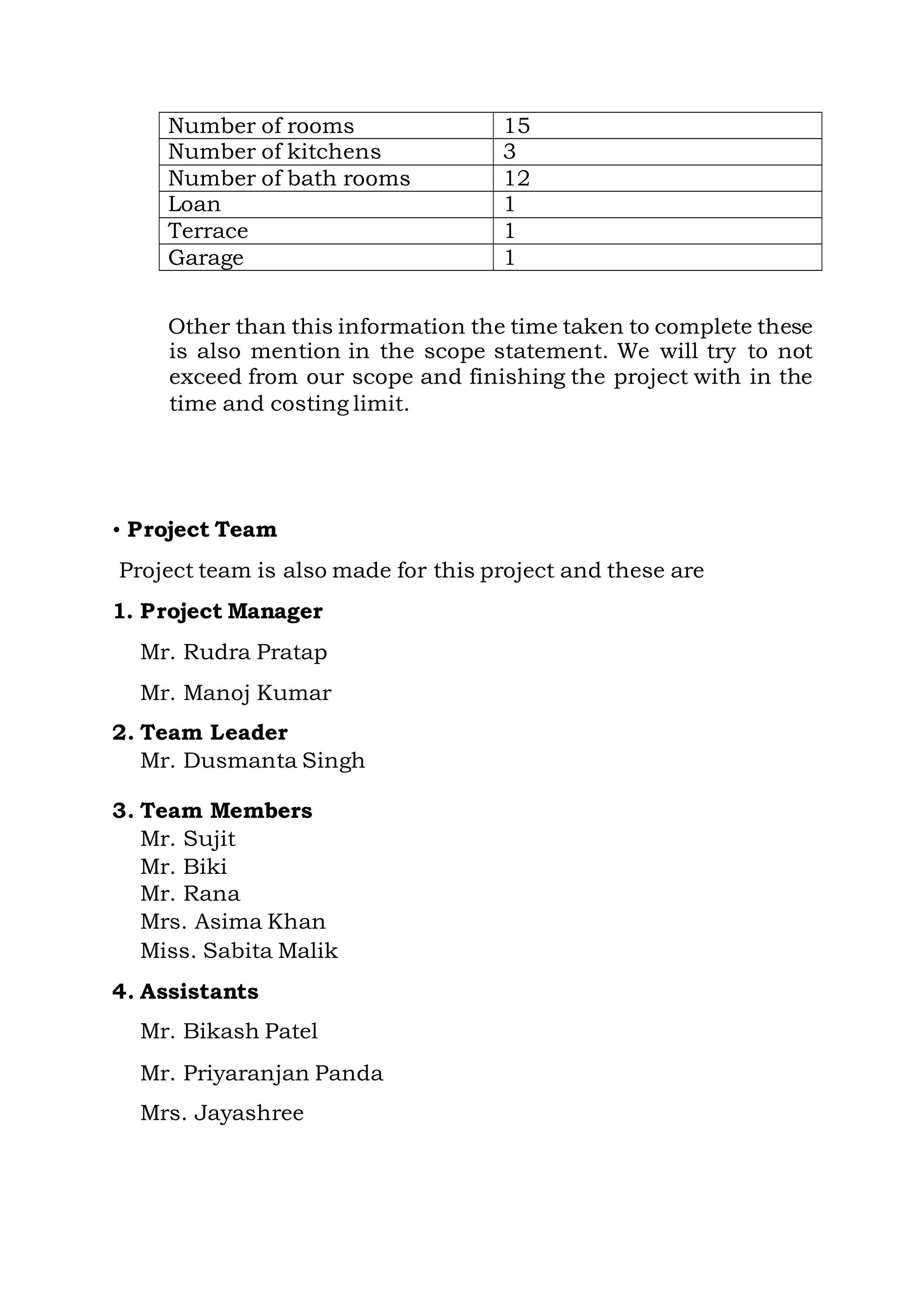

Number of rooms 15
Number of kitchens 3
Number of bath rooms 12
Loan 1
Terrace 1
Garage 1
Stakeholders:
Our main stakeholder is our customer who s Ali Hamza, then our
suppliers. These are the outsider’s stakeholders. With in the
company Project charter has a key stake in this project so project
manager is a stakeholder and the whole Royal Constructions.
Identify stakeholders
Identify Stakeholders is the process of identifying all people or
organizations impacted by the project or people who are the stake
in the project is stakeholder.
Inputs
All inputs are discussed above in Develop project charter. And these
are:
• Project charter
• Enterprise environment factors
• Organizational process assets
Tools and Techniques
Different tools and techniques are also used to identify stakeholder
like stakeholder analysis and expert judgement.
• stakeholder analysis
Our key stakeholder include
Mr. Akhaya Ratha
Royal company
Vendors/supplies
• Expert judgement
We are using some experts to analyse stakeholders and these
experts are
Mrs. Rosa Usman
Mrs. Sunita Kumari
Mr. Abdul Output
• Stakeholder register:
Stakeholder Role Involvement priority impact name
Ali Customer High Main Positive

A.G supplier Supplier Medium Main Positive Royal Contractor Medium
Main Positive construction
Manoj Kumar Project manager Very high Main Very
positive
• Stakeholder management strategy:
Use to increase support of stakeholders by giving them
information about project
Stakeholder Information given to the stakeholders
name
Ali Monthly progress of the project.
Project performance.
Information about the risks involved in project.
A.G supplier Monthly progress of the project.
Project performance.
Information about the risks involved in project.
Planning for the project
The Planning consists of those processes performed to establish
the total scope, define and refine the objectives, and develop the
course of action required to attain those objectives. The planning
processes develop the project management plan and the project
documents that will be used to carry out the project.
Planning process group:
Planning process group consist of 20 sub-processes. Starting
from the develop project management plan and end at
procurement.
Develop project plan
Develop Project Management Plan is the process of documenting
the actions necessary to define, prepare, integrate, and
coordinate all subsidiary plans. The project management plan
defines how the project is executed, monitored and controlled,
and closed.

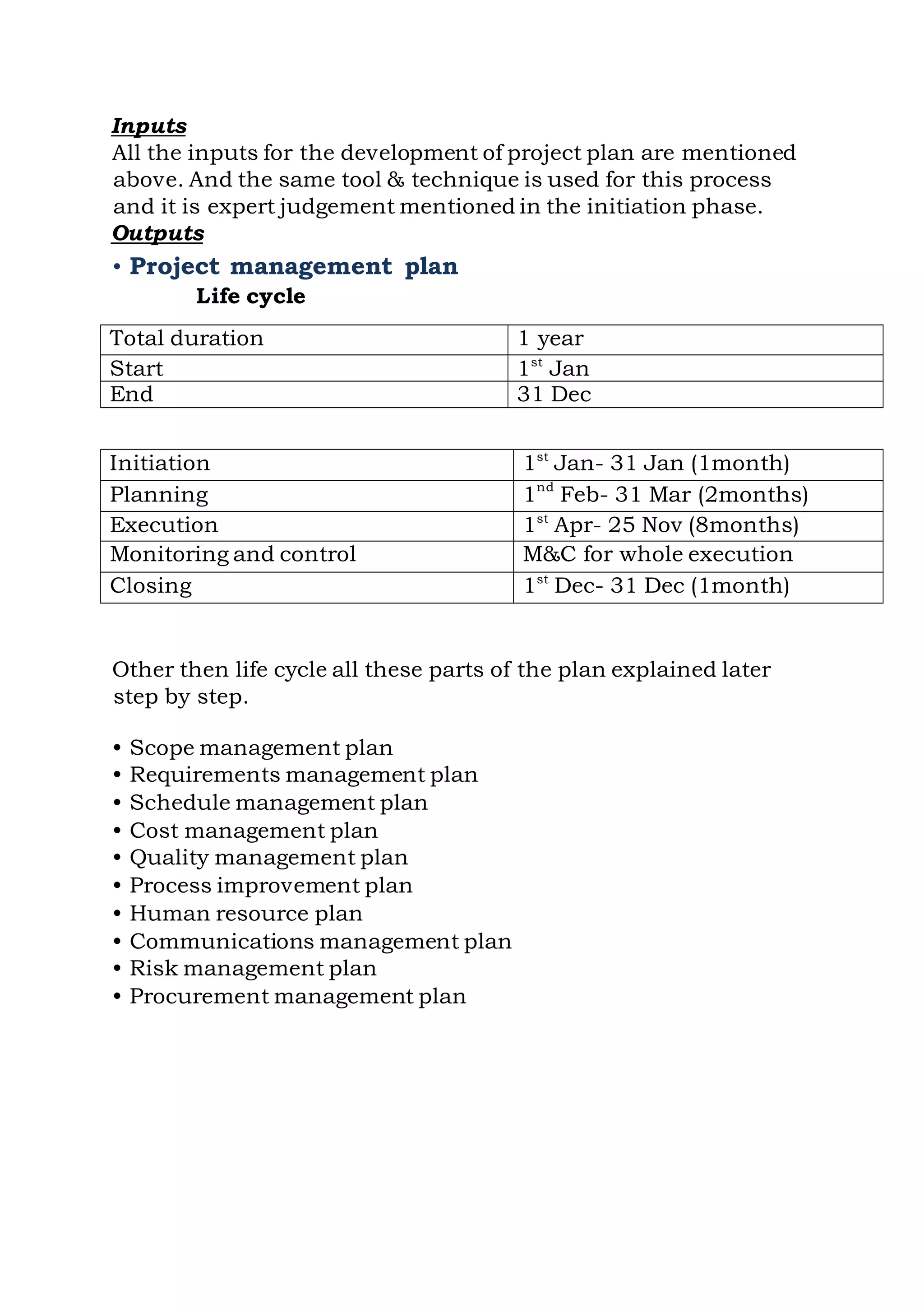

Inputs
All the inputs for the development of project plan are mentioned
above. And the same tool & technique is used for this process
and it is expert judgement mentioned in the initiation phase.
Outputs
• Project management plan
Other then life cycle all these parts of the plan explained later
step by step.
• Scope management plan
• Requirements management plan
• Schedule management plan
• Cost management plan
• Quality management plan
• Process improvement plan
• Human resource plan
• Communications management plan
• Risk management plan
• Procurement management plan
Life cycle
Total duration year1
Start 1st
Jan
End Dec31
Initiation 1st
Jan- 31 Jan (1month)
Planning 1nd
Feb- 31 Mar (2months)
Execution 1st
Apr- 25 Nov (8months)
Monitoring and control M&C for whole execution
Closing 1st
Dec- 31 Dec (1month)

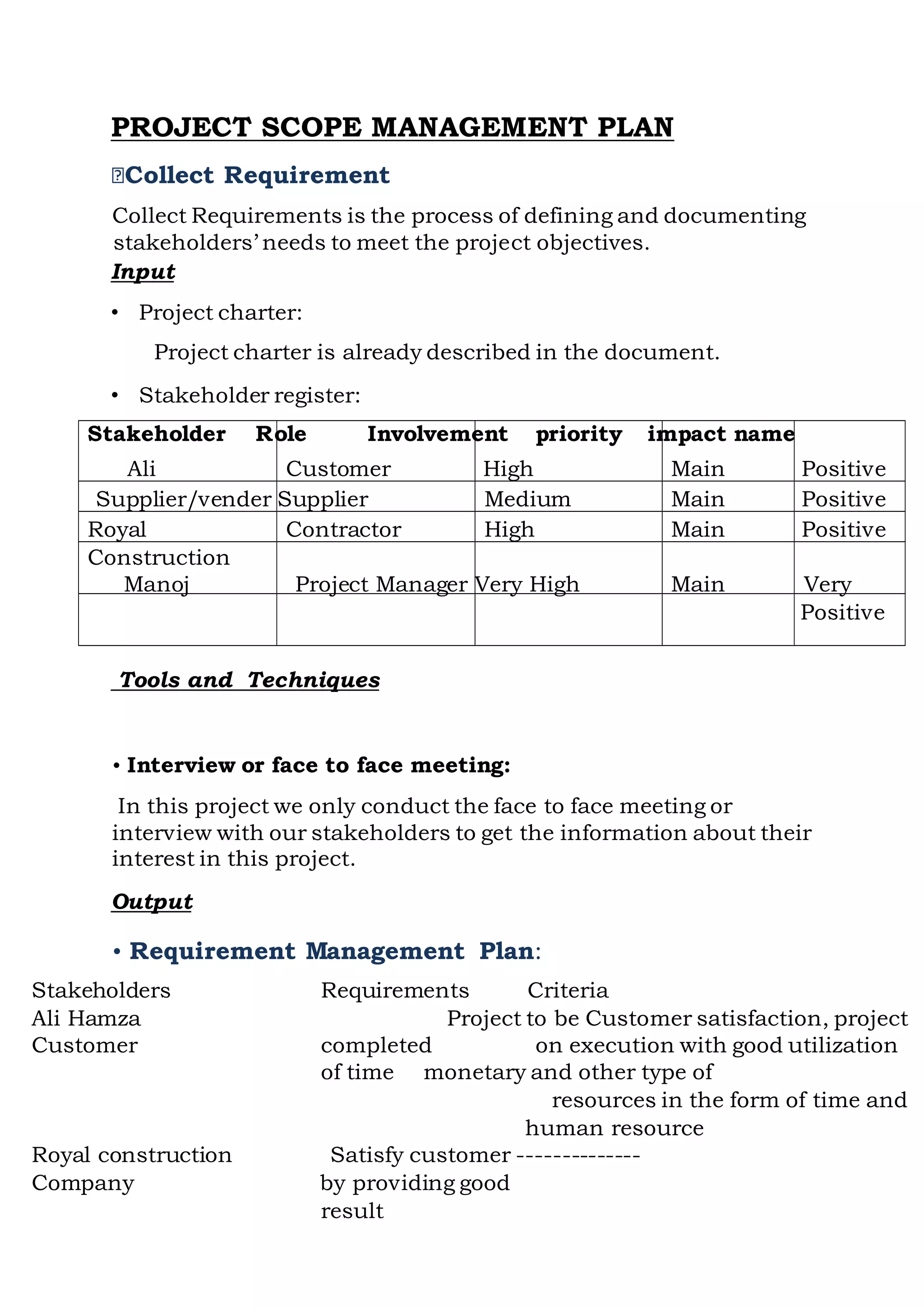

PROJECT SCOPE MANAGEMENT PLAN
Collect Requirement
Collect Requirements is the process of defining and documenting
stakeholders’ needs to meet the project objectives.
Input
• Project charter:
Project charter is already described in the document.
• Stakeholder register:
Stakeholder Role Involvement priority impact name
Ali Customer High Main Positive
Supplier/vender Supplier Medium Main Positive
Royal Contractor High Main Positive
Construction
Manoj Project Manager Very High Main Very
Positive
Tools and Techniques
• Interview or face to face meeting:
In this project we only conduct the face to face meeting or
interview with our stakeholders to get the information about their
interest in this project.
Output
• Requirement Management Plan:
Stakeholders Requirements Criteria
Ali Hamza Project to be Customer satisfaction, project
Customer completed on execution with good utilization
of time monetary and other type of
resources in the form of time and
human resource
Royal construction Satisfy customer --------------
Company by providing good
result

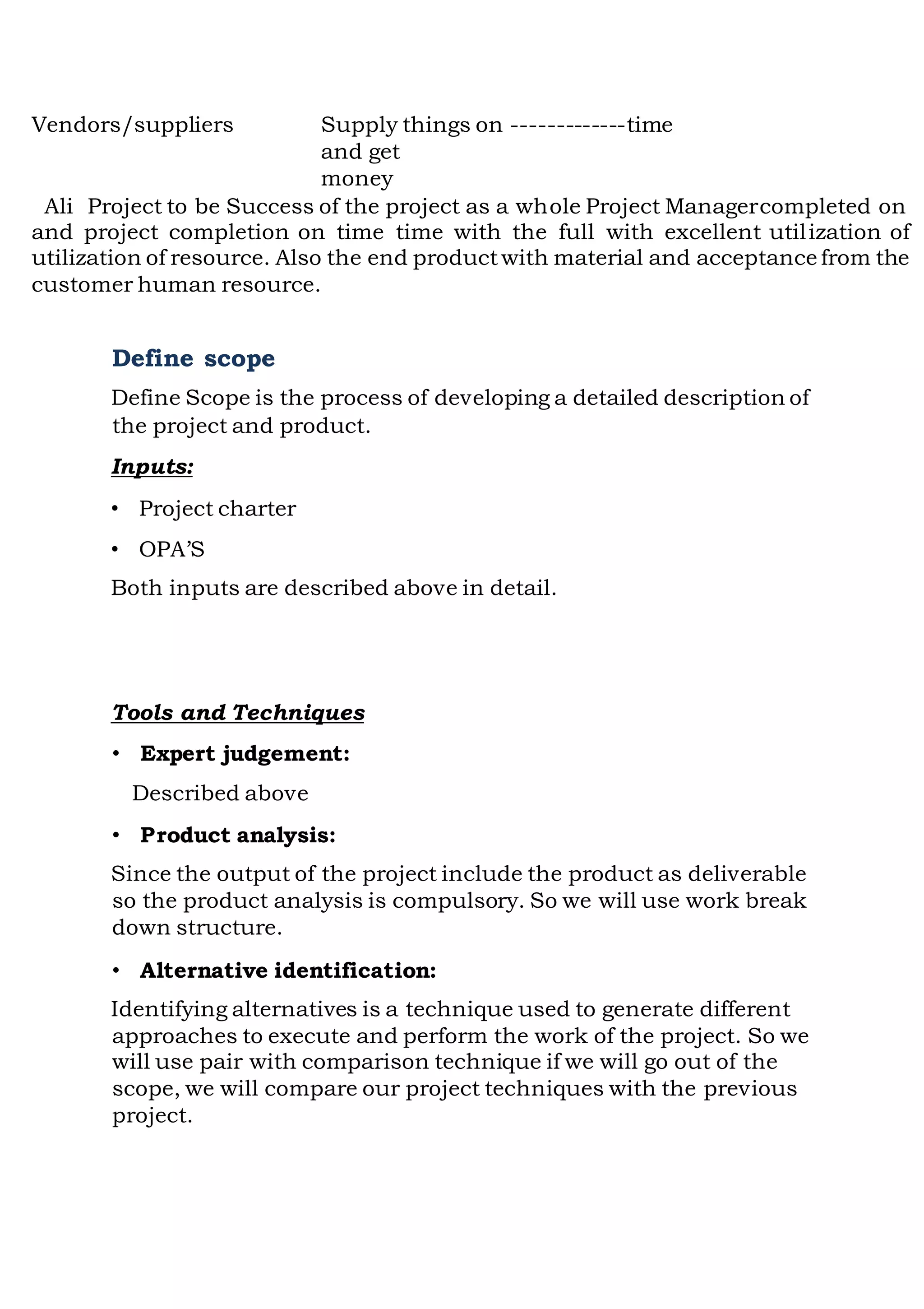

Vendors/suppliers Supply things on -------------time
and get
money
Ali Project to be Success of the project as a whole Project Managercompleted on
and project completion on time time with the full with excellent utilization of
utilization of resource. Also the end productwith material and acceptance from the
customer human resource.
Define scope
Define Scope is the process of developing a detailed description of
the project and product.
Inputs:
• Project charter
• OPA’S
Both inputs are described above in detail.
Tools and Techniques
• Expert judgement:
Described above
• Product analysis:
Since the output of the project include the product as deliverable
so the product analysis is compulsory. So we will use work break
down structure.
• Alternative identification:
Identifying alternatives is a technique used to generate different
approaches to execute and perform the work of the project. So we
will use pair with comparison technique if we will go out of the
scope, we will compare our project techniques with the previous
project.

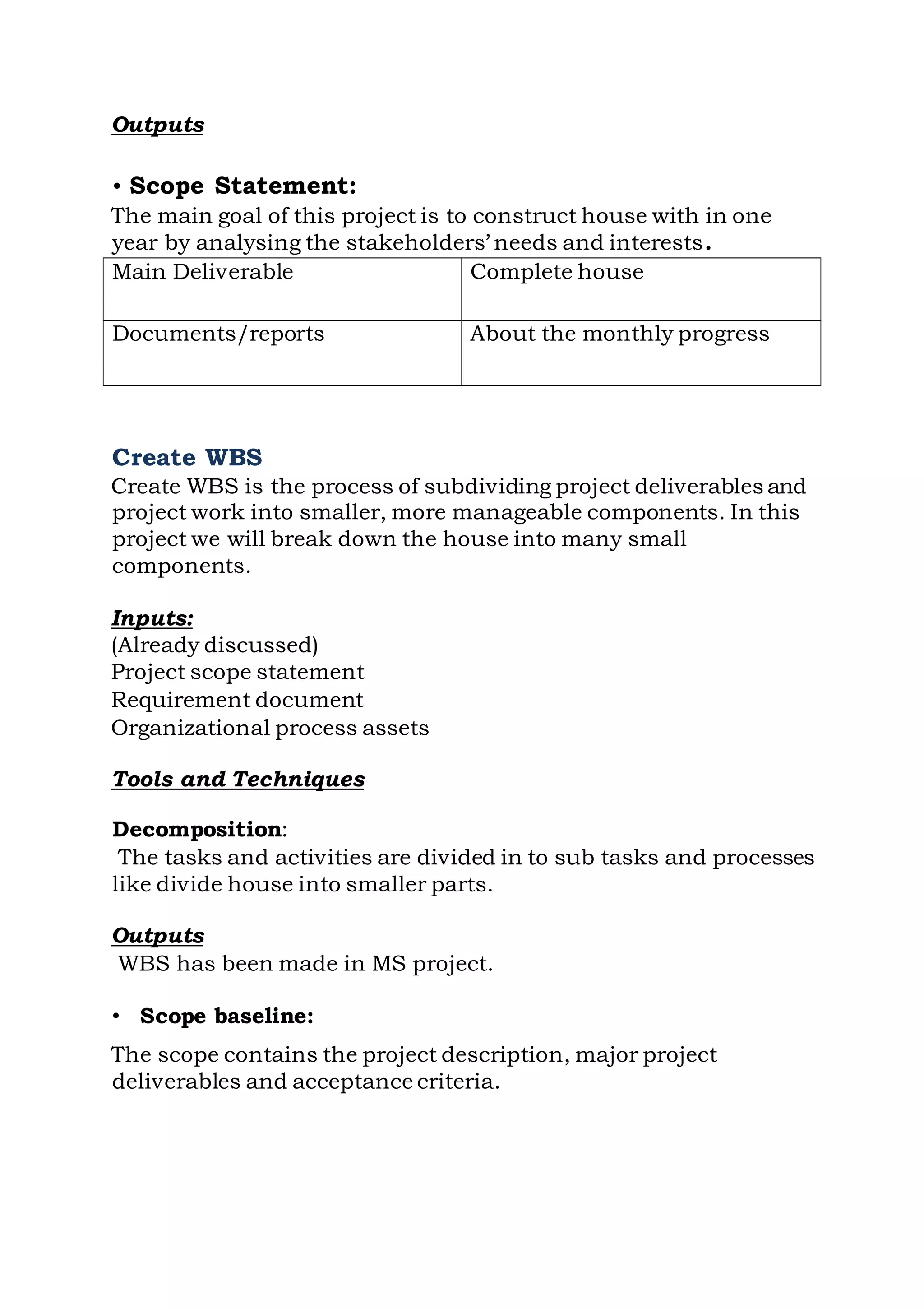

Outputs
• Scope Statement:
The main goal of this project is to construct house with in one
year by analysing the stakeholders’ needs and interests.
Create WBS
Create WBS is the process of subdividing project deliverables and
project work into smaller, more manageable components. In this
project we will break down the house into many small
components.
Inputs:
(Already discussed)
Project scope statement
Requirement document
Organizational process assets
Tools and Techniques
Decomposition:
The tasks and activities are divided in to sub tasks and processes
like divide house into smaller parts.
Outputs
WBS has been made in MS project.
• Scope baseline:
The scope contains the project description, major project
deliverables and acceptance criteria.
Main Deliverable Complete house
Documents/reports About the monthly progress
• Description:

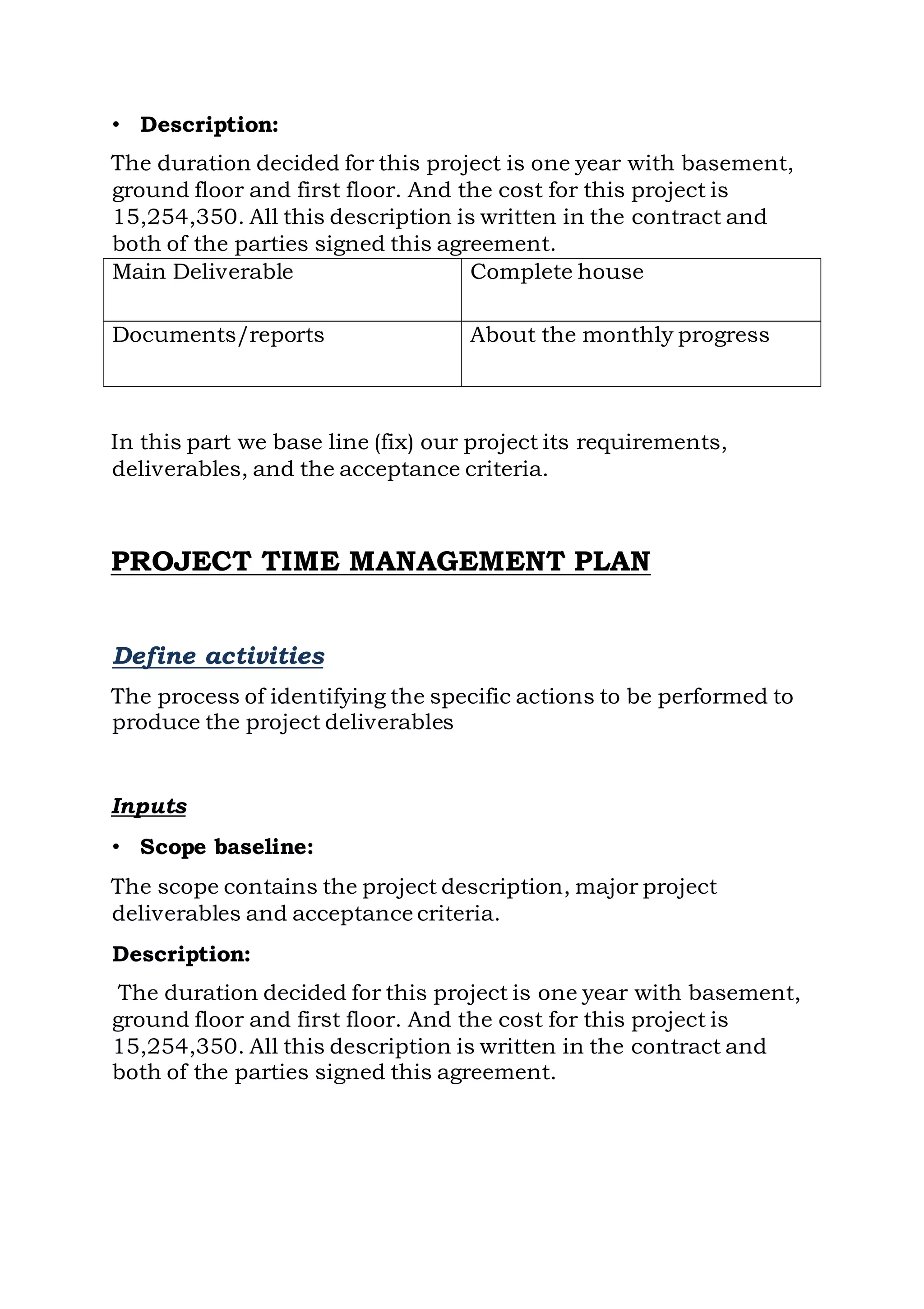

The duration decided for this project is one year with basement,
ground floor and first floor. And the cost for this project is
15,254,350. All this description is written in the contract and
both of the parties signed this agreement.
In this part we base line (fix) our project its requirements,
deliverables, and the acceptance criteria.
PROJECT TIME MANAGEMENT PLAN
Define activities
The process of identifying the specific actions to be performed to
produce the project deliverables
Inputs
• Scope baseline:
The scope contains the project description, major project
deliverables and acceptance criteria.
Description:
The duration decided for this project is one year with basement,
ground floor and first floor. And the cost for this project is
15,254,350. All this description is written in the contract and
both of the parties signed this agreement.
Main Deliverable Complete house
Documents/reports About the monthly progress

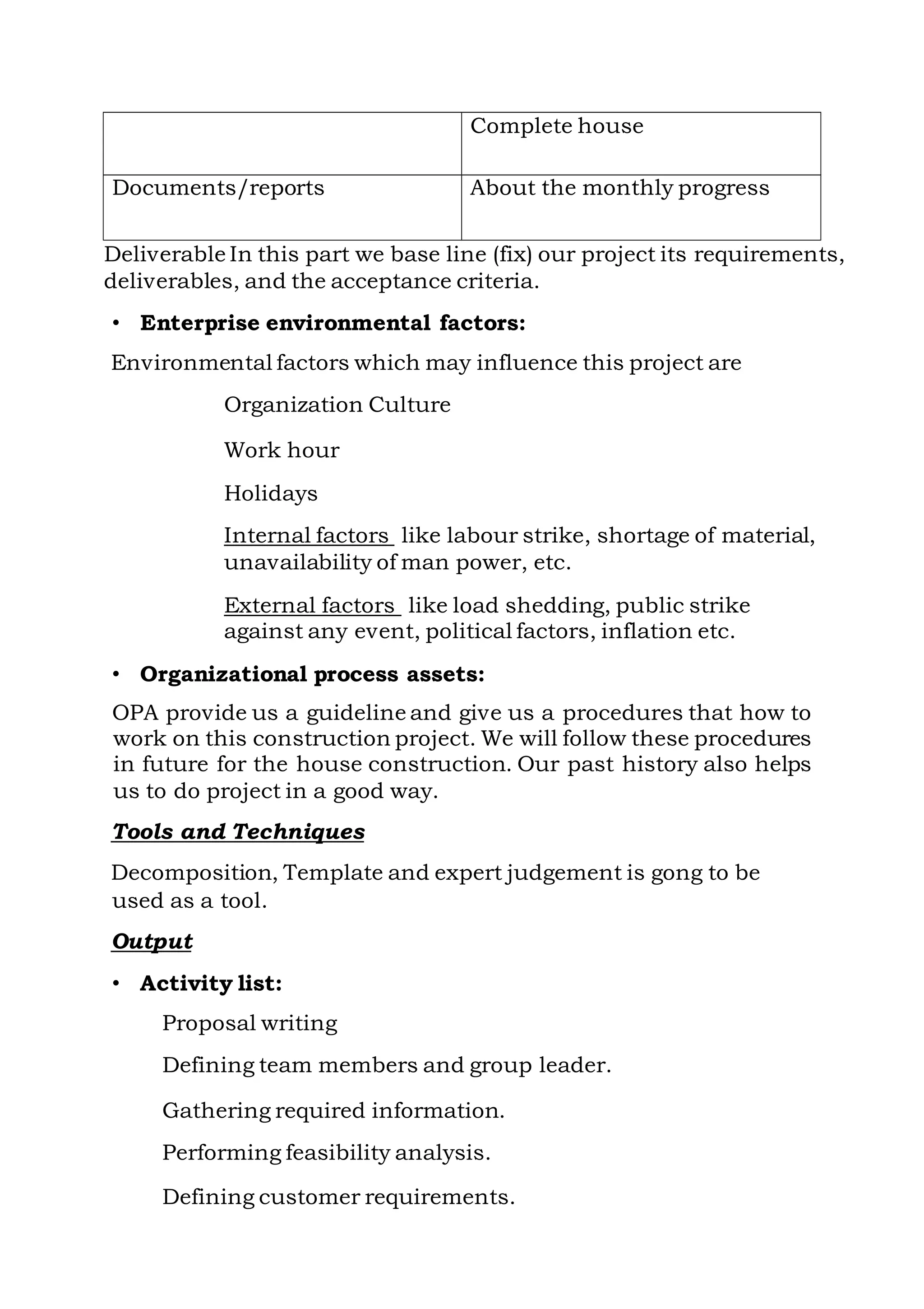

Deliverable In this part we base line (fix) our project its requirements,
deliverables, and the acceptance criteria.
• Enterprise environmental factors:
Environmental factors which may influence this project are
Organization Culture
Work hour
Holidays
Internal factors like labour strike, shortage of material,
unavailability of man power, etc.
External factors like load shedding, public strike
against any event, political factors, inflation etc.
• Organizational process assets:
OPA provide us a guideline and give us a procedures that how to
work on this construction project. We will follow these procedures
in future for the house construction. Our past history also helps
us to do project in a good way.
Tools and Techniques
Decomposition, Template and expert judgement is gong to be
used as a tool.
Output
• Activity list:
Proposal writing
Defining team members and group leader.
Gathering required information.
Performing feasibility analysis.
Defining customer requirements.
Complete house
Documents/reports About the monthly progress
Develop project charter.
Identifying stakeholders.
Collecting requirements.
Project Costing.
Project Budgeting.
Scheduling.
Project scope management planning.
Project scope statement writing Scope baseline.
Defining accepted work deliverables.
Project risk management planning.
Project communication management planning.
Project quality management planning.
Project procurement management planning.
Whole construction
• Milestone list
Main task is construction of structure.
Mandatory tasks Target date
Approval of Charter 31 Jan 2017
Project plan completion 1st Mar 2017
Approval of project plan 15 Mar 2017
Selection of project team 31 Mar 2017
Execution started 1st April 2017
Execution completed 25 Nov 2017
Closing 31 Dec 2017
Sequence Activities
Sequence Activities is the process of identifying and
documenting relationships among the project activities.

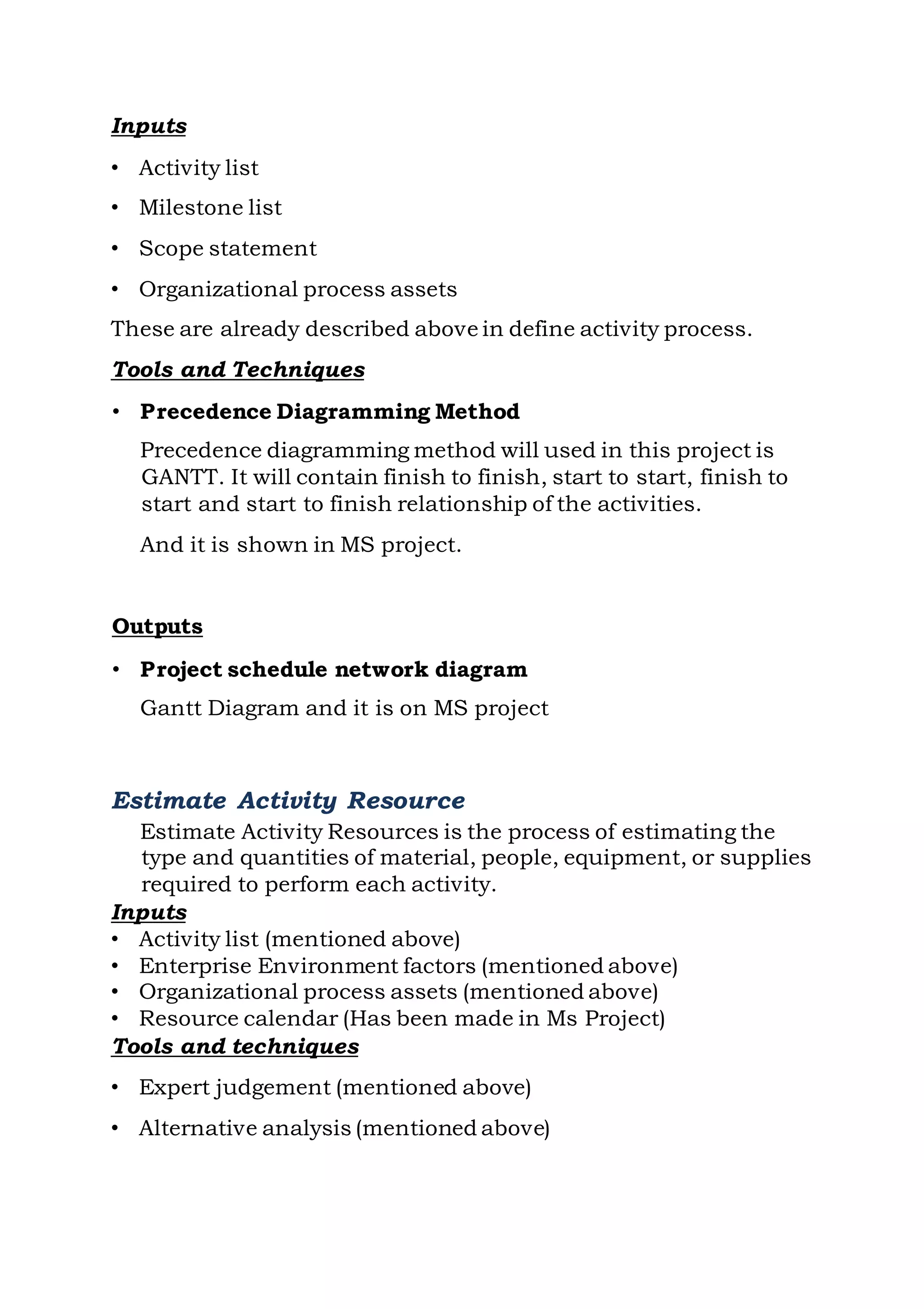

Inputs
• Activity list
• Milestone list
• Scope statement
• Organizational process assets
These are already described above in define activity process.
Tools and Techniques
• Precedence Diagramming Method
Precedence diagramming method will used in this project is
GANTT. It will contain finish to finish, start to start, finish to
start and start to finish relationship of the activities.
And it is shown in MS project.
Outputs
• Project schedule network diagram
Gantt Diagram and it is on MS project
Estimate Activity Resource
Estimate Activity Resources is the process of estimating the
type and quantities of material, people, equipment, or supplies
required to perform each activity.
Inputs
• Activity list (mentioned above)
• Enterprise Environment factors (mentioned above)
• Organizational process assets (mentioned above)
• Resource calendar (Has been made in Ms Project)
Tools and techniques
• Expert judgement (mentioned above)
• Alternative analysis (mentioned above)
Outputs

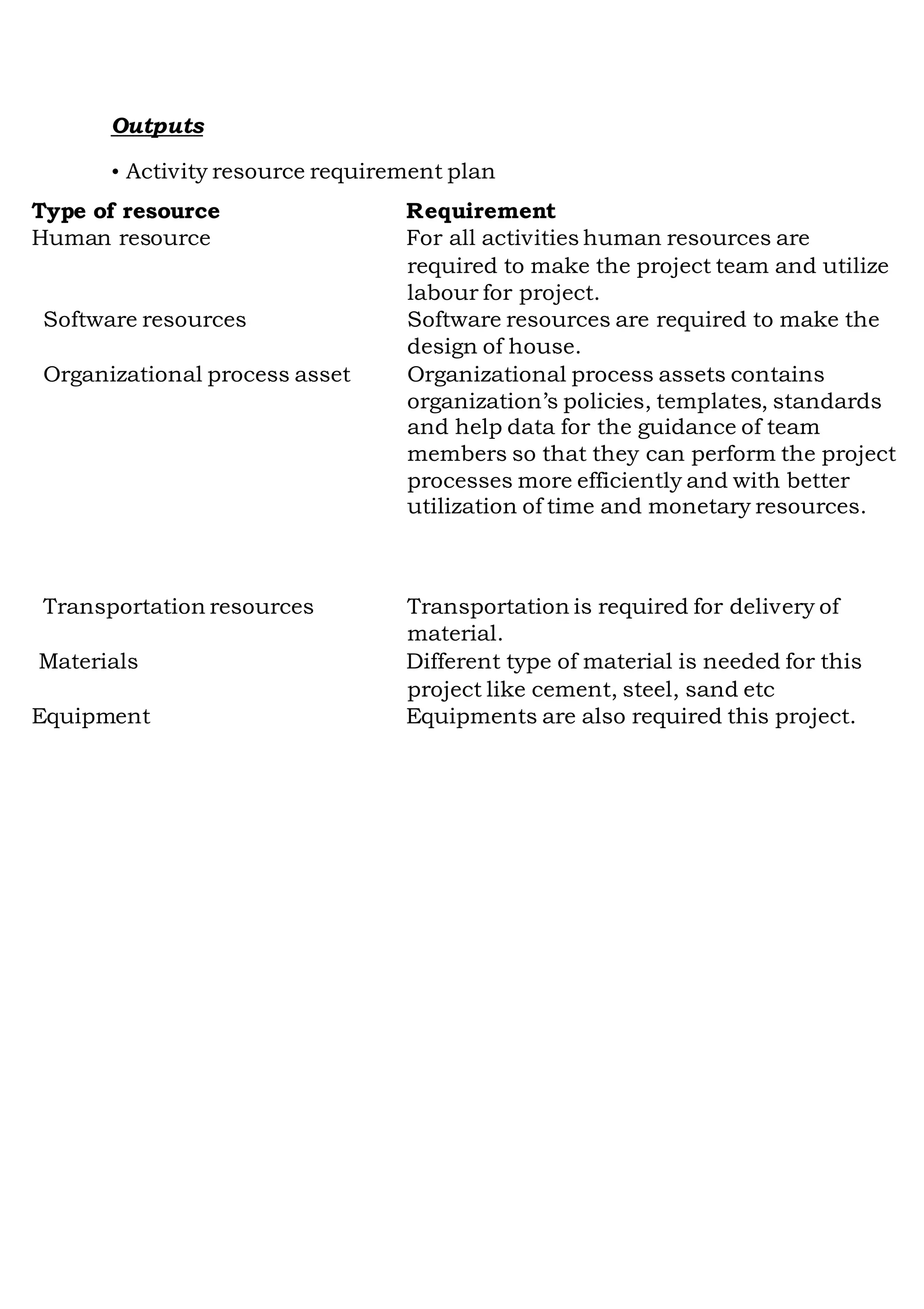

• Activity resource requirement plan
Type of resource Requirement
Human resource For all activities human resources are
required to make the project team and utilize
labour for project.
Software resources Software resources are required to make the
design of house.
Organizational process asset Organizational process assets contains
organization’s policies, templates, standards
and help data for the guidance of team
members so that they can perform the project
processes more efficiently and with better
utilization of time and monetary resources.
Transportation resources Transportation is required for delivery of
material.
Materials Different type of material is needed for this
project like cement, steel, sand etc
Equipment Equipments are also required this project.

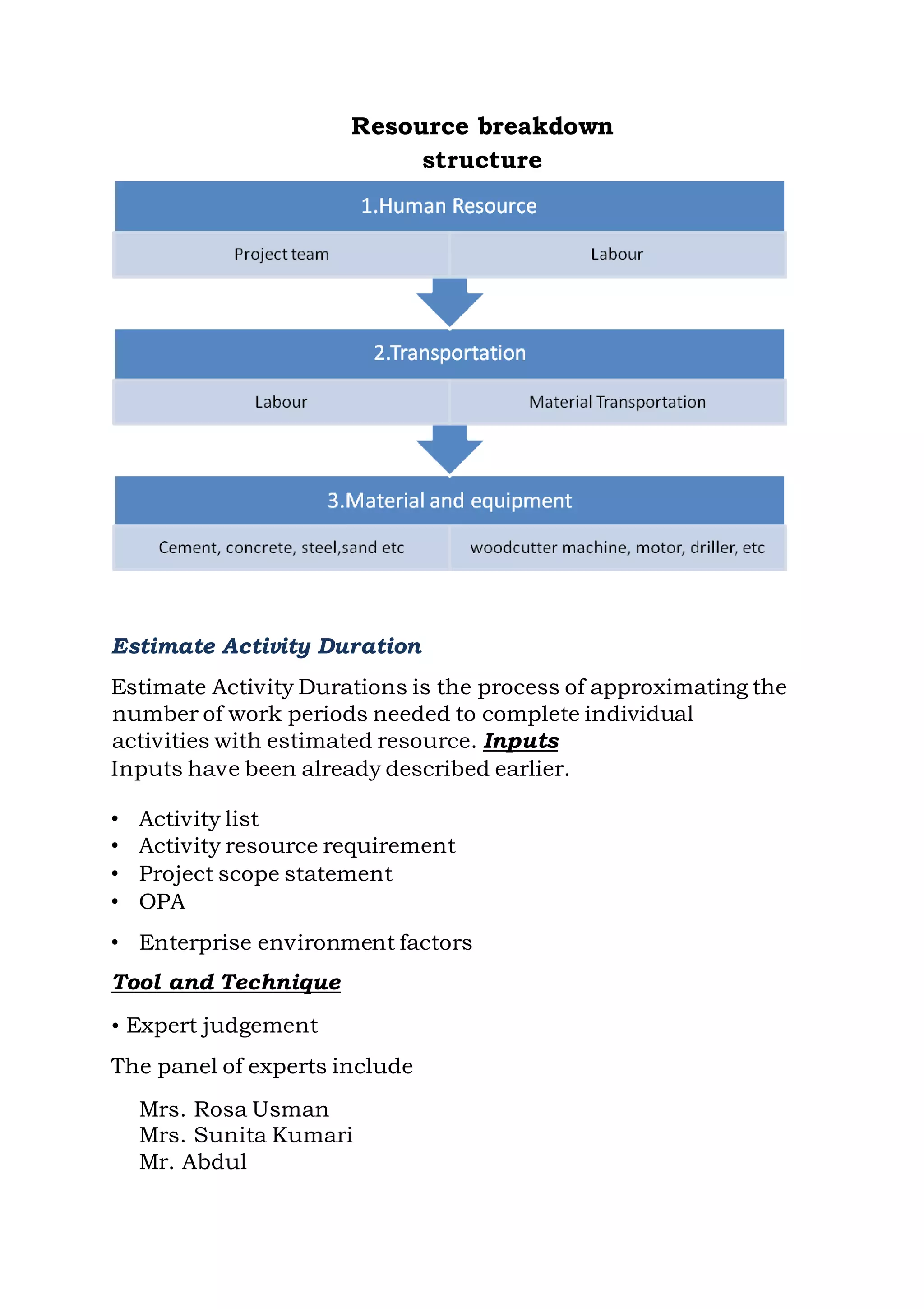

Resource breakdown
structure
Estimate Activity Duration
Estimate Activity Durations is the process of approximating the
number of work periods needed to complete individual
activities with estimated resource. Inputs
Inputs have been already described earlier.
• Activity list
• Activity resource requirement
• Project scope statement
• OPA
• Enterprise environment factors
Tool and Technique
• Expert judgement
The panel of experts include
Mrs. Rosa Usman
Mrs. Sunita Kumari
Mr. Abdul

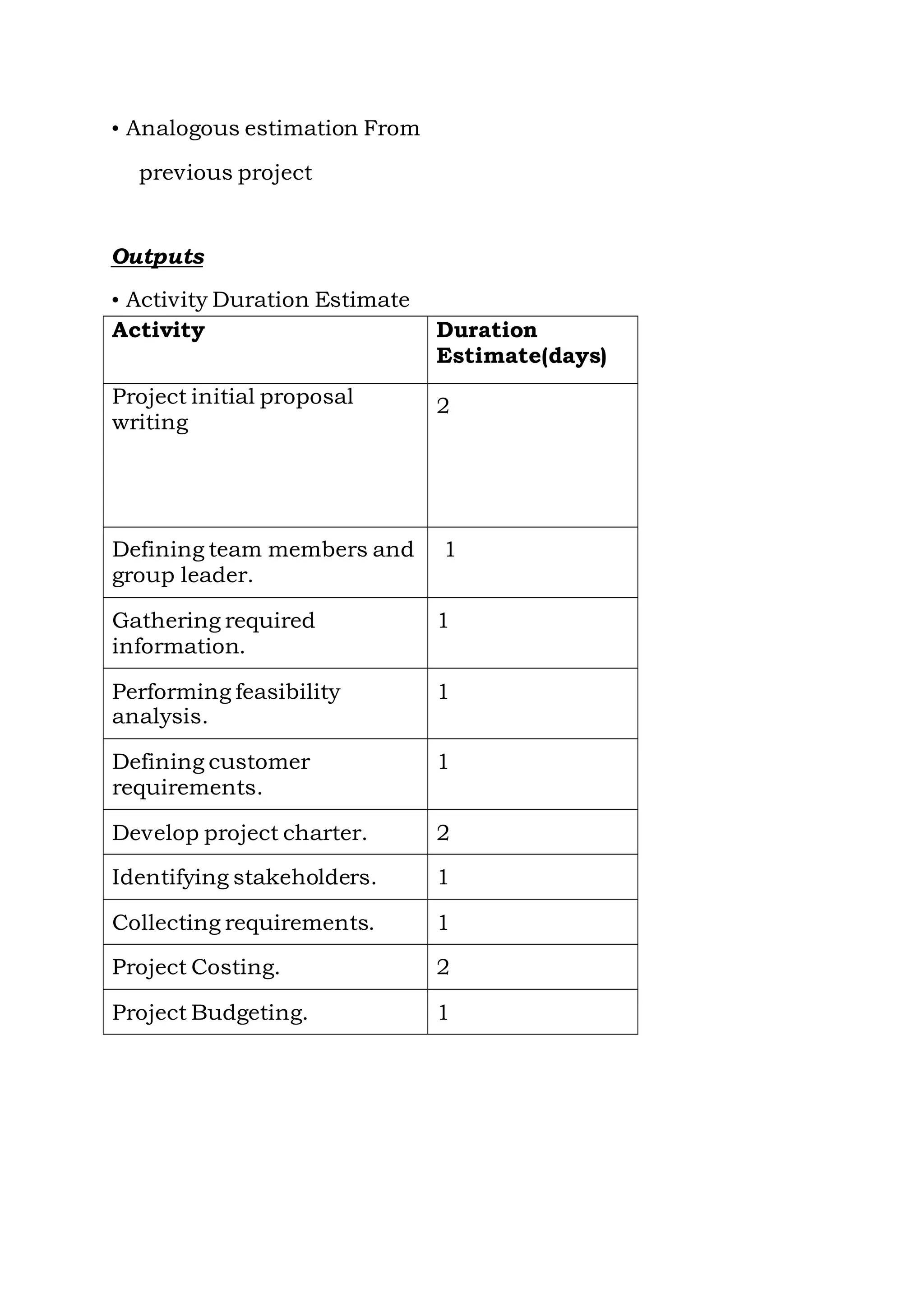

• Analogous estimation From
previous project
Outputs
• Activity Duration Estimate
Activity Duration
Estimate(days)
Project initial proposal
writing
2
Defining team members and
group leader.
1
Gathering required
information.
1
Performing feasibility
analysis.
1
Defining customer
requirements.
1
Develop project charter. 2
Identifying stakeholders. 1
Collecting requirements. 1
Project Costing. 2
Project Budgeting. 1

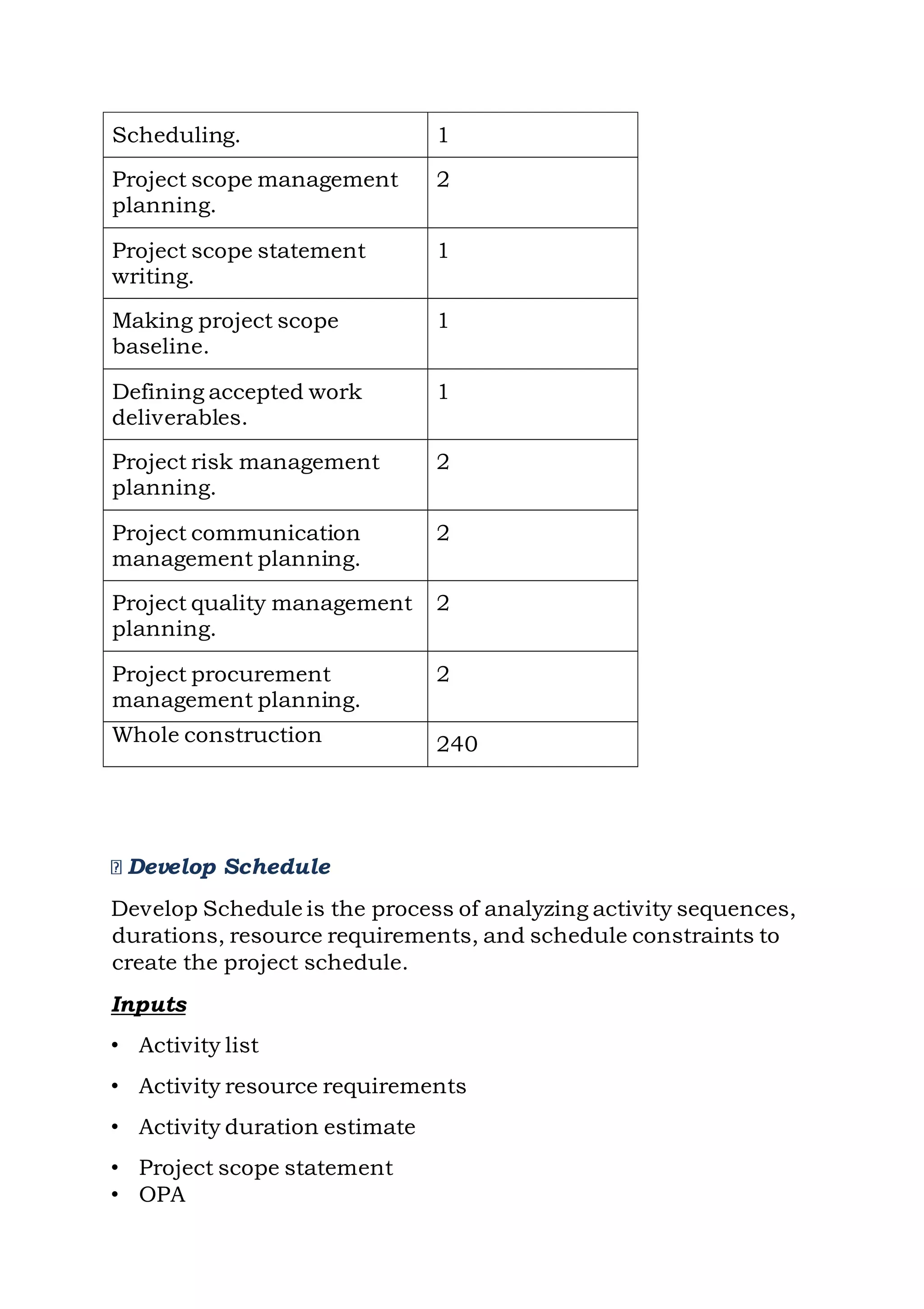

Develop Schedule
Develop Schedule is the process of analyzing activity sequences,
durations, resource requirements, and schedule constraints to
create the project schedule.
Inputs
• Activity list
• Activity resource requirements
• Activity duration estimate
• Project scope statement
• OPA
Scheduling. 1
Project scope management
planning.
2
Project scope statement
writing.
1
Making project scope
baseline.
1
Defining accepted work
deliverables.
1
Project risk management
planning.
2
Project communication
management planning.
2
Project quality management
planning.
2
Project procurement
management planning.
2
Whole construction 240
• Environment factors
Tools and Techniques
• Resource levelling
• Critical Path method
It is made in MS project.
Output

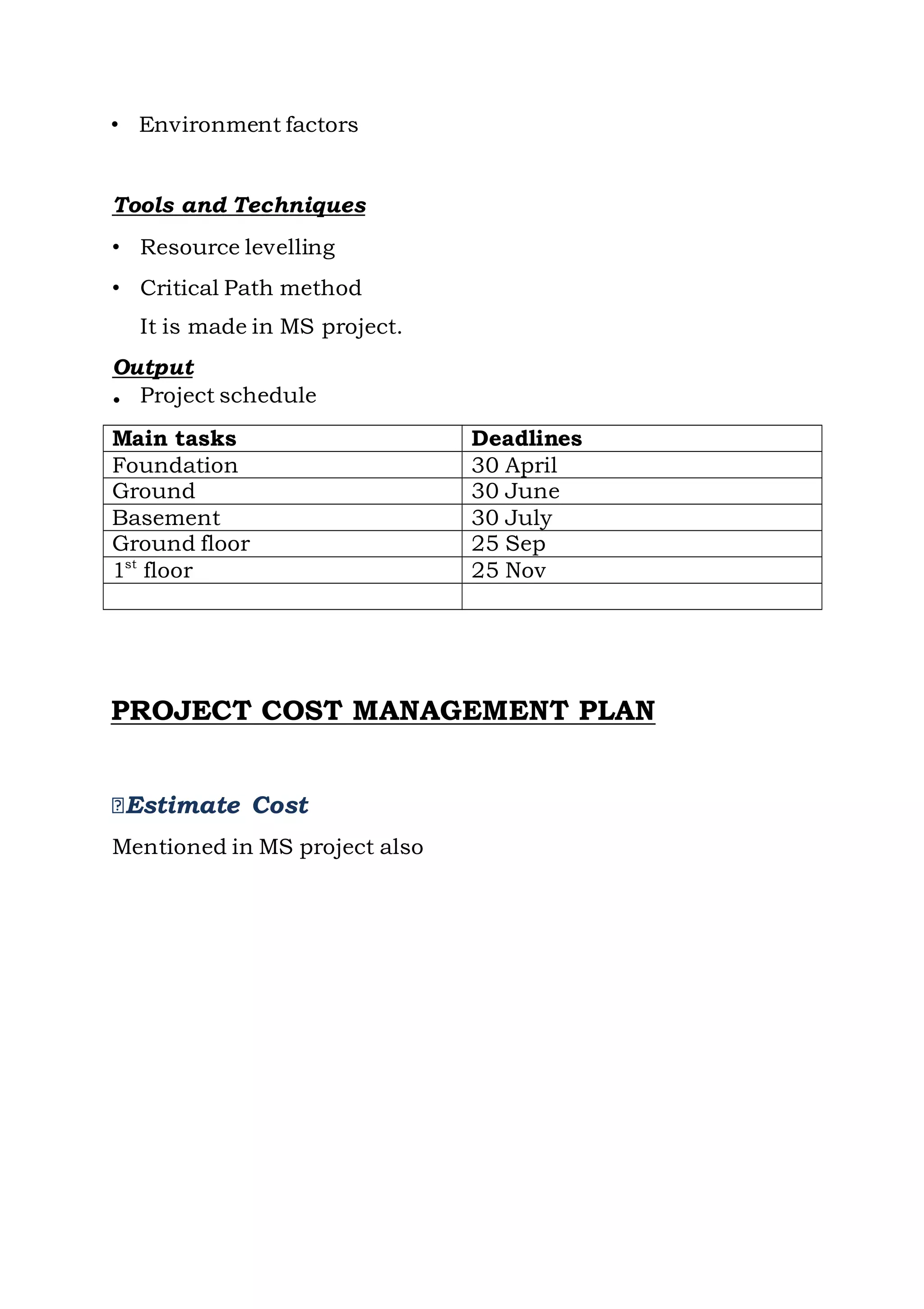

PROJECT COST MANAGEMENT PLAN
Estimate Cost
Mentioned in MS project also
• Project schedule
Main tasks Deadlines
Foundation 30 April
Ground 30 June
Basement 30 July
Ground floor 25 Sep
1st
floor 25 Nov
Determine Budget
Total budget is 15,254,350 for this project

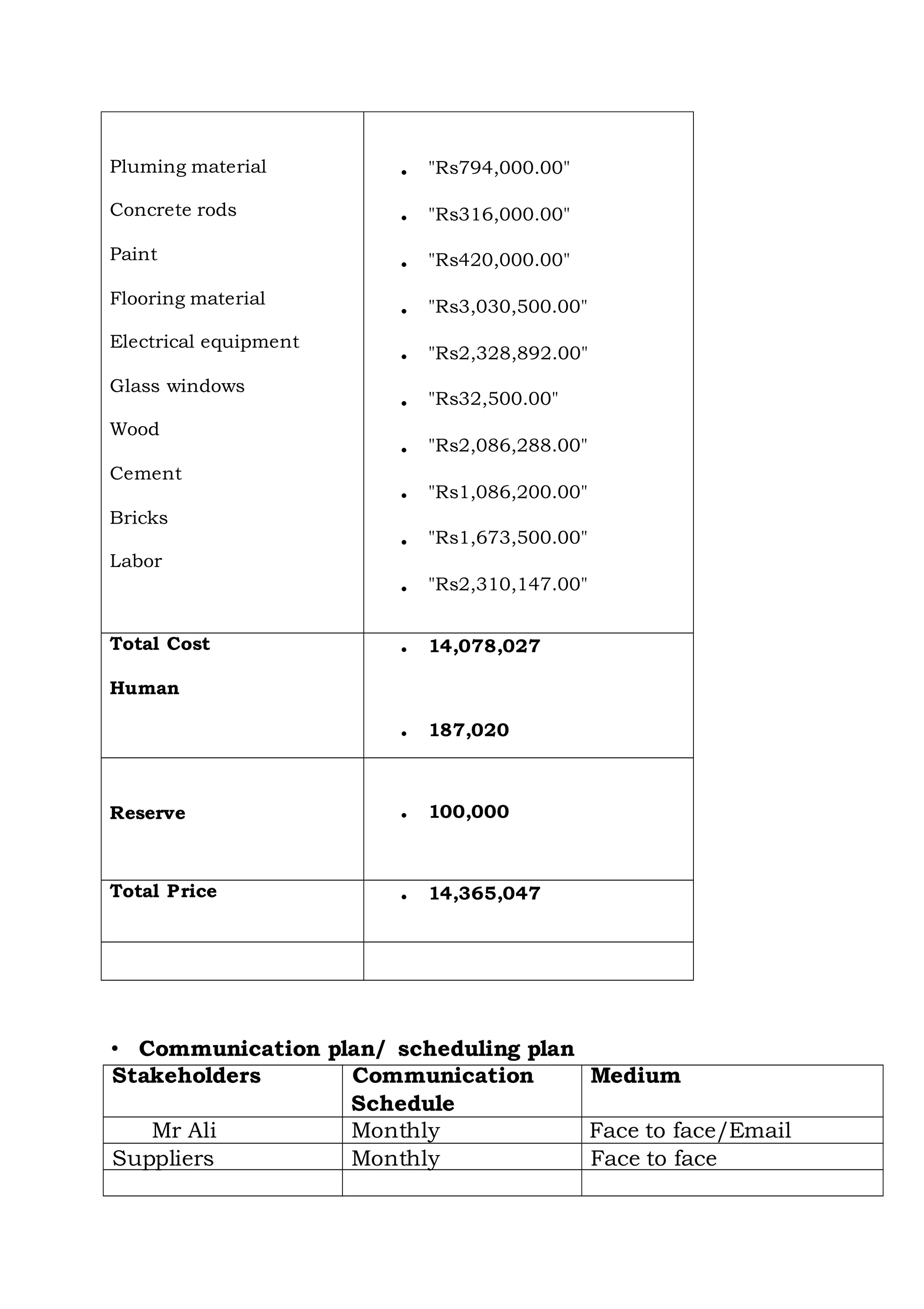

Work Cost
Pluming material
Concrete rods
Paint
Flooring material
Electrical equipment
Glass windows
Wood
Cement
Bricks
Labor
• "Rs794,000.00"
• "Rs316,000.00"
• "Rs420,000.00"
• "Rs3,030,500.00"
• "Rs2,328,892.00"
• "Rs32,500.00"
• "Rs2,086,288.00"
• "Rs1,086,200.00"
• "Rs1,673,500.00"
• "Rs2,310,147.00"
Total Cost
Human
• 14,078,027
• 187,020
Reserve • 100,000
Total Price • 14,365,047

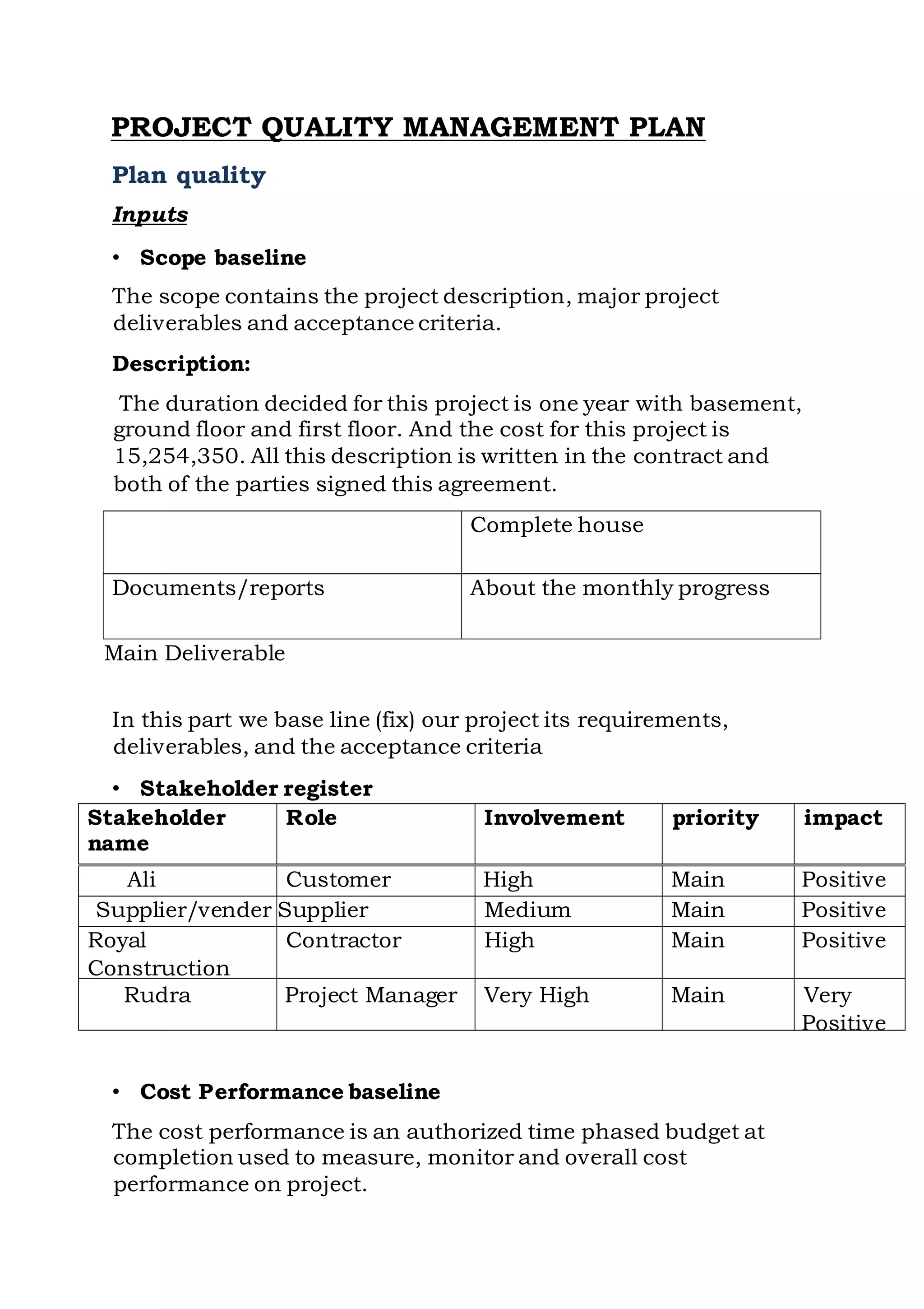

PROJECT QUALITY MANAGEMENT PLAN
Plan quality
Inputs
• Scope baseline
The scope contains the project description, major project
deliverables and acceptance criteria.
Description:
The duration decided for this project is one year with basement,
ground floor and first floor. And the cost for this project is
15,254,350. All this description is written in the contract and
both of the parties signed this agreement.
Main Deliverable
In this part we base line (fix) our project its requirements,
deliverables, and the acceptance criteria
• Stakeholder register
Ali Customer High Main Positive
Supplier/vender Supplier Medium Main Positive
Royal Contractor High Main Positive
Construction
Rudra Project Manager Very High Main Very
Positive
• Cost Performance baseline
The cost performance is an authorized time phased budget at
completion used to measure, monitor and overall cost
performance on project.
Complete house
Documents/reports About the monthly progress
Stakeholder
name
Role Involvement priority impact

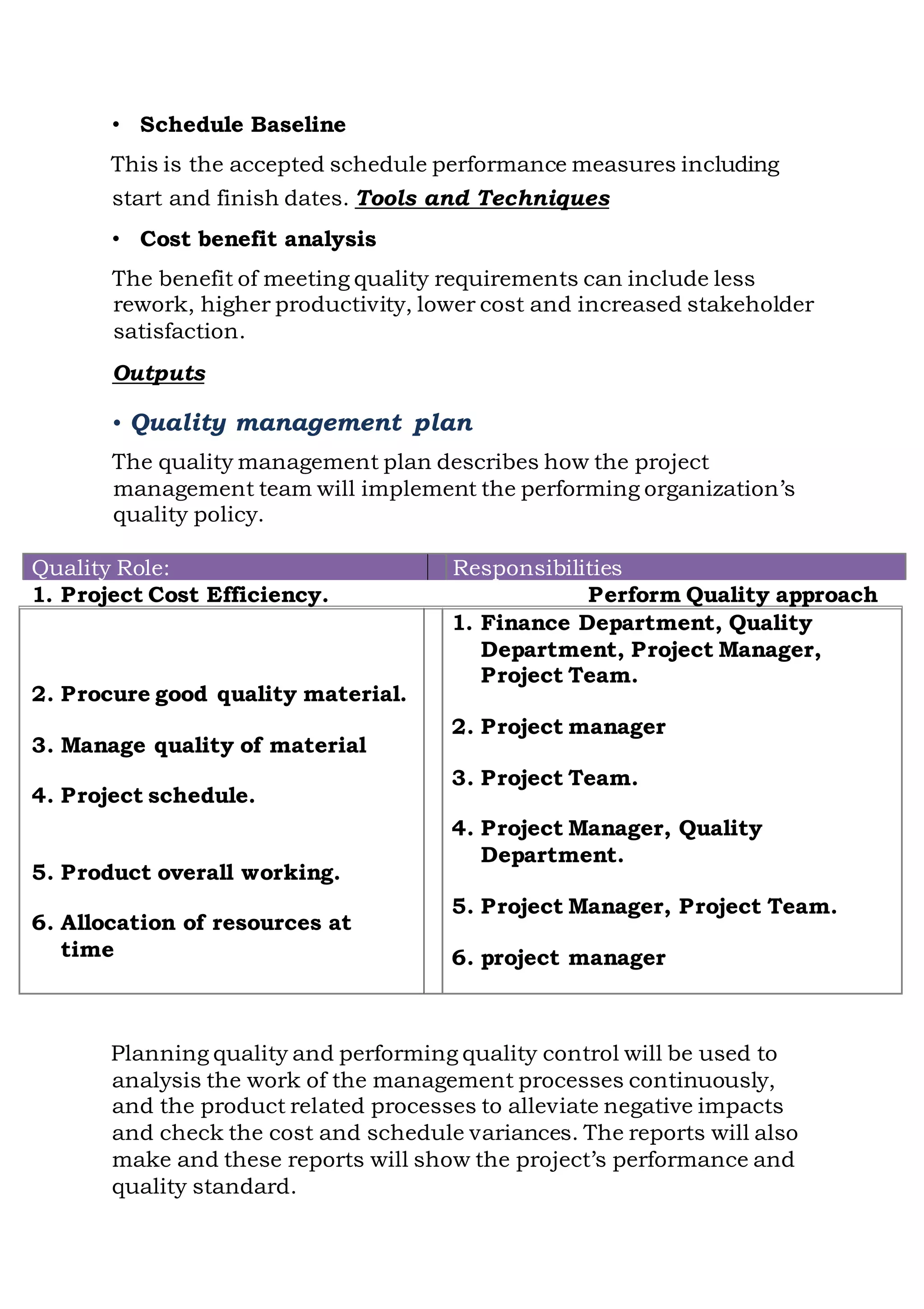

• Schedule Baseline
This is the accepted schedule performance measures including
start and finish dates. Tools and Techniques
• Cost benefit analysis

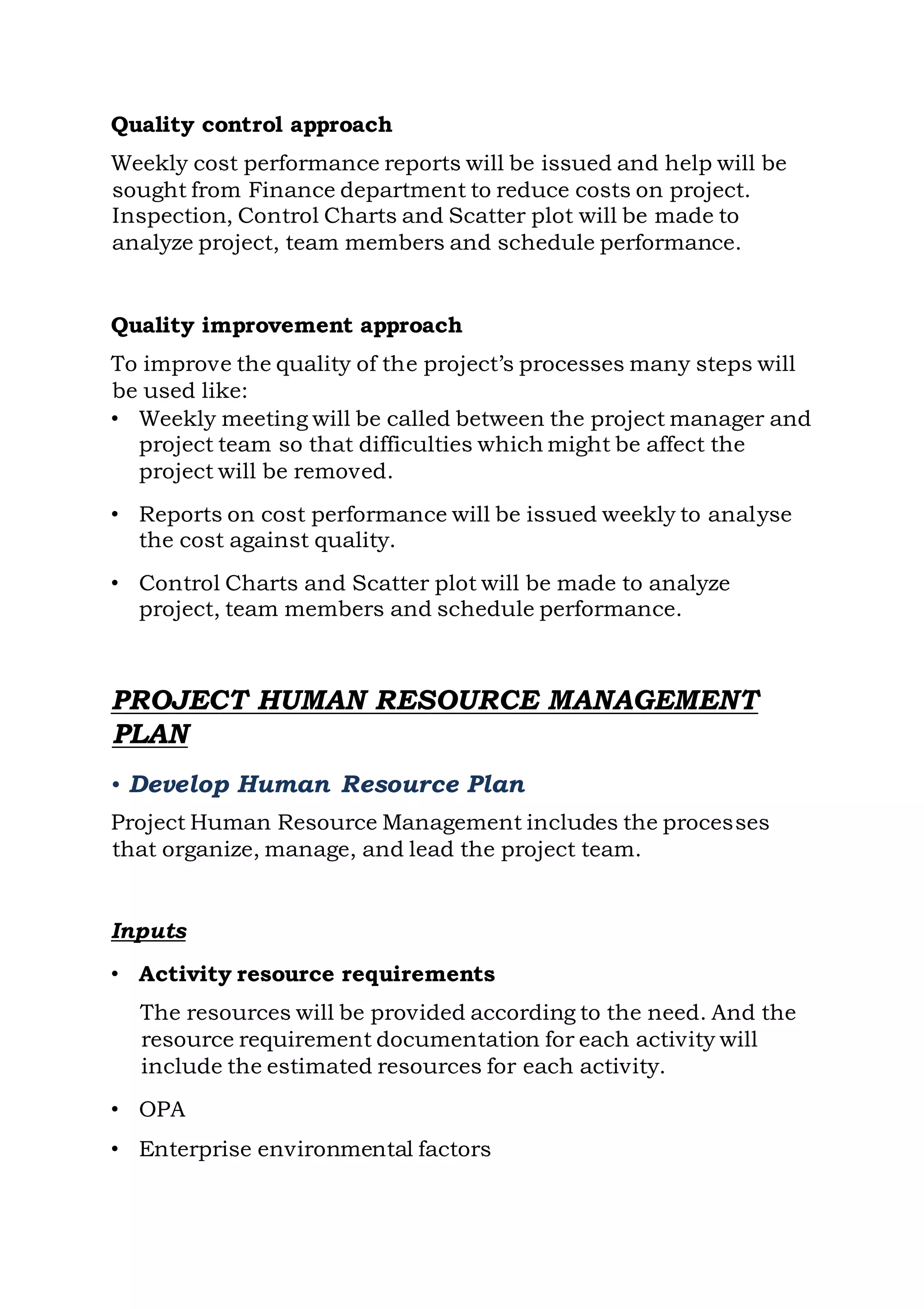

The benefit of meeting quality requirements can include less
rework, higher productivity, lower cost and increased stakeholder
satisfaction.
Outputs
• Quality management plan
The quality management plan describes how the project
management team will implement the performing organization’s
quality policy.
Quality Role: Responsibilities
1. Project Cost Efficiency.
2. Procure good quality material.
3. Manage quality of material
4. Project schedule.
5. Product overall working.
6. Allocation of resources at
time
Perform Quality approach
1. Finance Department, Quality
Department, Project Manager,
Project Team.
2. Project manager
3. Project Team.
4. Project Manager, Quality
Department.
5. Project Manager, Project Team.
6. project manager
Planning quality and performing quality control will be used to
analysis the work of the management processes continuously,
and the product related processes to alleviate negative impacts
and check the cost and schedule variances. The reports will also
make and these reports will show the project’s performance and
quality standard.
Quality control approach
Weekly cost performance reports will be issued and help will be
sought from Finance department to reduce costs on project.
Inspection, Control Charts and Scatter plot will be made to
analyze project, team members and schedule performance.
Quality improvement approach
To improve the quality of the project’s processes many steps will
be used like:
• Weekly meeting will be called between the project manager and
project team so that difficulties which might be affect the
project will be removed.
• Reports on cost performance will be issued weekly to analyse
the cost against quality.
• Control Charts and Scatter plot will be made to analyze
project, team members and schedule performance.
PROJECT HUMAN RESOURCE MANAGEMENT
PLAN
• Develop Human Resource Plan
Project Human Resource Management includes the processes
that organize, manage, and lead the project team.
Inputs
• Activity resource requirements
The resources will be provided according to the need. And the
resource requirement documentation for each activity will
include the estimated resources for each activity.
• OPA
• Enterprise environmental factors
Tools and techniques

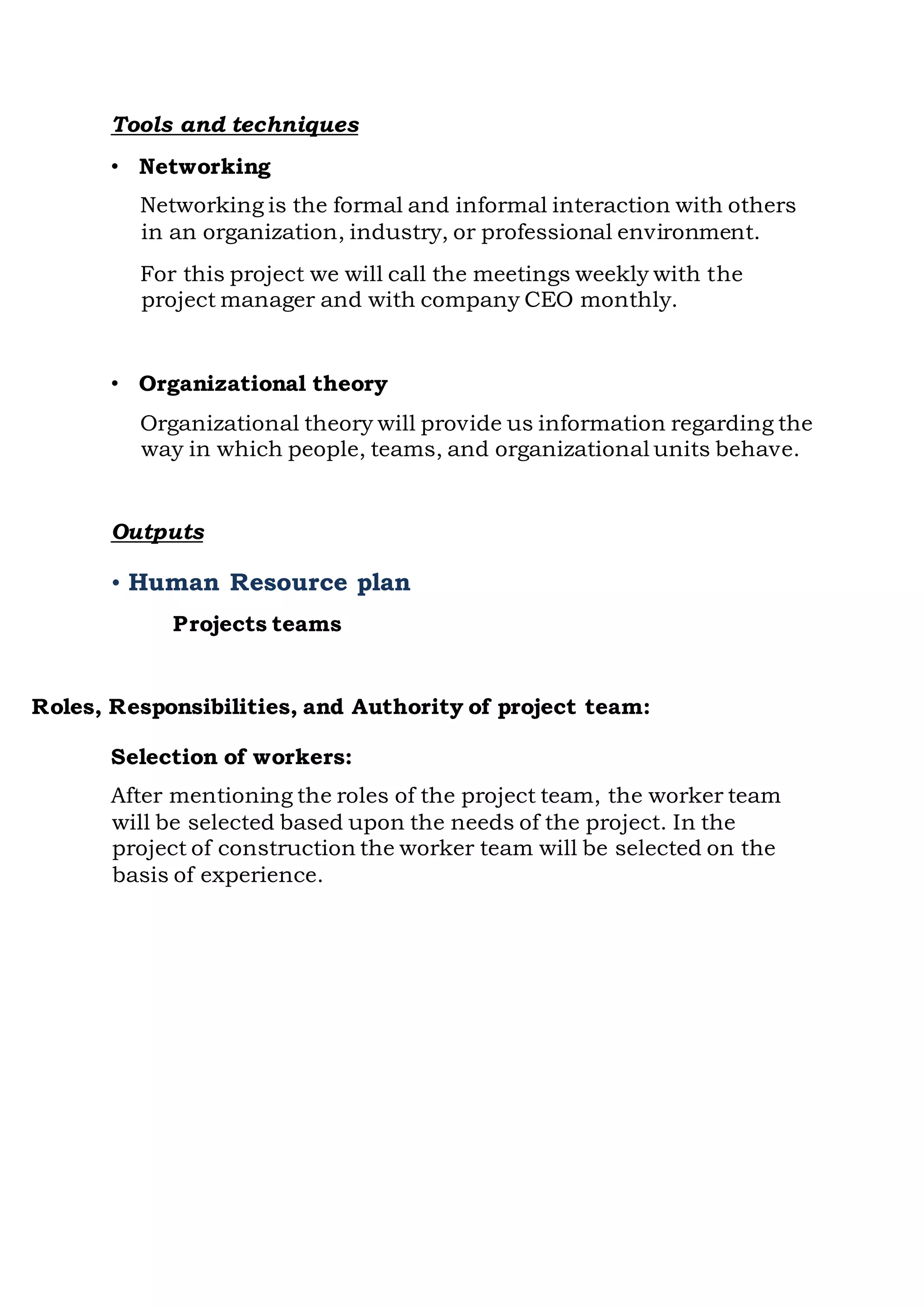

• Networking
Networking is the formal and informal interaction with others
in an organization, industry, or professional environment.
For this project we will call the meetings weekly with the
project manager and with company CEO monthly.
• Organizational theory
Organizational theory will provide us information regarding the
way in which people, teams, and organizational units behave.
Outputs
• Human Resource plan
Projects teams
Roles, Responsibilities, and Authority of project team:
Selection of workers:
After mentioning the roles of the project team, the worker team
will be selected based upon the needs of the project. In the
project of construction the worker team will be selected on the
basis of experience.

PROJECT RISK MANAGEMENT PLAN
Plan Risk Management
The processes of defining how to conduct risk management
activities for a project are described in Risk management plan.
Inputs
• Project scope statement
• Cost management plan
Work Cost
• Communication plan/ scheduling plan
Stakeholders Communication Medium
Schedule
Mr Ali Monthly Face to face/Email
Suppliers Monthly Face to face
Pluming material
Concrete rods
Paint
Flooring material
Electrical equipment
Glass windows
Wood
Cement
Bricks
Labor
• "Rs794,000.00"
• "Rs316,000.00"
• "Rs420,000.00"
• "Rs3,030,500.00"
• "Rs2,328,892.00"
• "Rs32,500.00"
• "Rs2,086,288.00"
• "Rs1,086,200.00"
• "Rs1,673,500.00"
• "Rs2,310,147.00"
Total Cost
Human
• 14,078,027
• 187,020
Reserve • 100,000
Total Price • 14,365,047

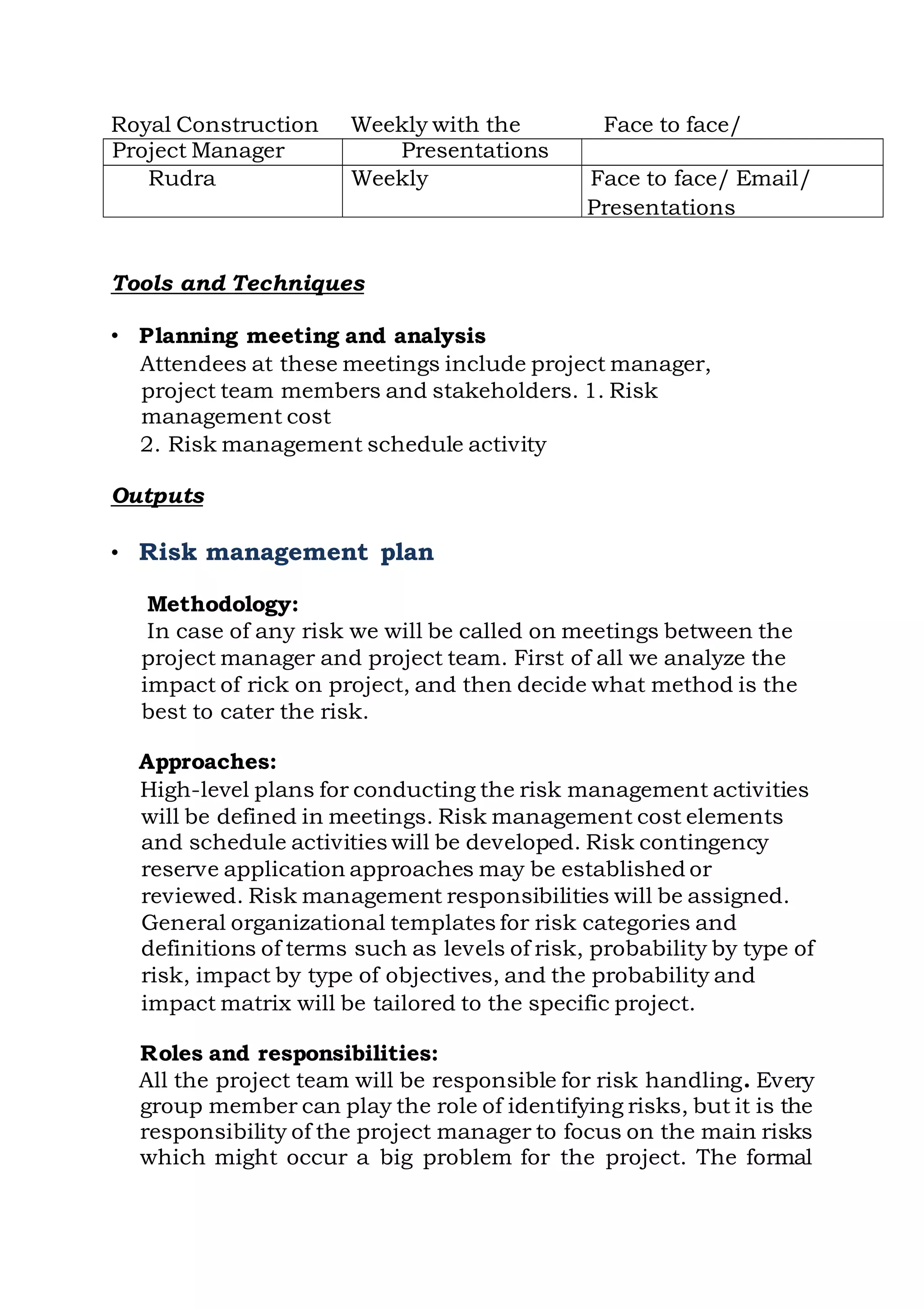

Royal Construction Weekly with the Face to face/
Project Manager Presentations
Rudra Weekly Face to face/ Email/
Presentations
Tools and Techniques
• Planning meeting and analysis
Attendees at these meetings include project manager,
project team members and stakeholders. 1. Risk
management cost
2. Risk management schedule activity
Outputs
• Risk management plan
Methodology:
In case of any risk we will be called on meetings between the
project manager and project team. First of all we analyze the
impact of rick on project, and then decide what method is the
best to cater the risk.
Approaches:
High-level plans for conducting the risk management activities
will be defined in meetings. Risk management cost elements
and schedule activities will be developed. Risk contingency
reserve application approaches may be established or
reviewed. Risk management responsibilities will be assigned.
General organizational templates for risk categories and
definitions of terms such as levels of risk, probability by type of
risk, impact by type of objectives, and the probability and
impact matrix will be tailored to the specific project.
Roles and responsibilities:
All the project team will be responsible for risk handling. Every
group member can play the role of identifying risks, but it is the
responsibility of the project manager to focus on the main risks
which might occur a big problem for the project. The formal
document will be prepared by the project manager after
consulting with team members and after identification of the
risks. And this document will be forwarded to the CEO so that
he would also know about the risks. If risks will not be handled
by the project manager then it will be the responsibility of CEO
to solve these risks.
Timings:
In this project we will perform risk management whenever risk
occurs.
Identify risks
Identify Risks is the process of determining which risks may
affect the project and documenting their characteristics.
Inputs
• Risk management plan Methodology:
In case of any risk we will be called on meetings between the
project manager and project team. First of all we analyze the
impact of rick on project. and then decide what method is best
for cater the risk.
Approaches:
High-level plans for conducting the risk management activities
will be defined in meetings. Risk management cost elements
and schedule activities will be developed. Risk contingency
reserve application approaches may be established or
reviewed. Risk management responsibilities will be assigned.
General organizational templates for risk categories and
definitions of terms such as levels of risk, probability by type of
risk, impact by type of objectives, and the probability and
impact matrix will be tailored to the specific project.
Roles and responsibilities:
All the project team will be responsible for risk handling. Every
group member can play the role of identifying risks, but it is the
responsibility of the project manager to focus on the main risks

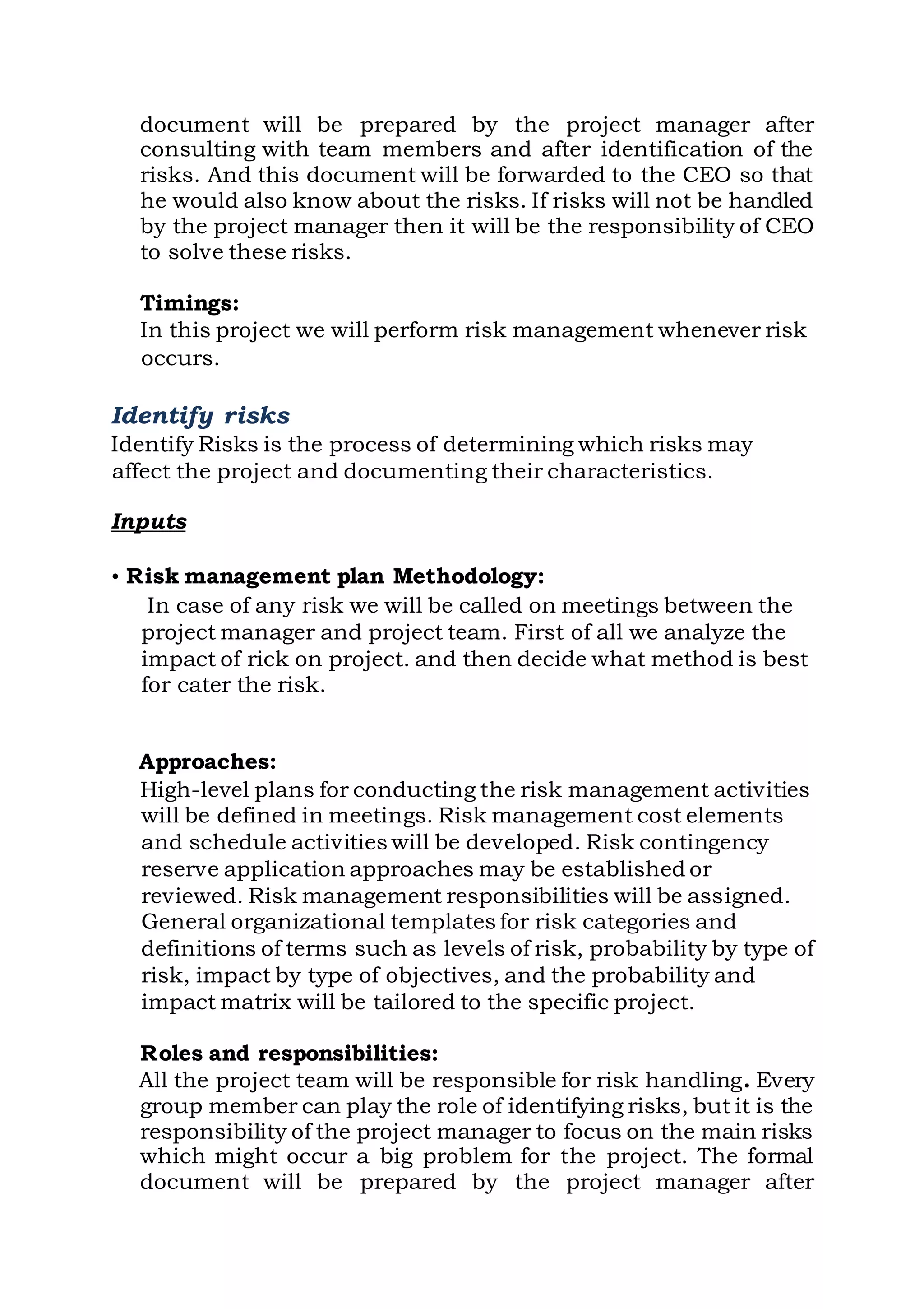

which might occur a big problem for the project. The formal
document will be prepared by the project manager after
consulting with team members and after identification of the
risks. And this document will be forwarded to the CEO so that

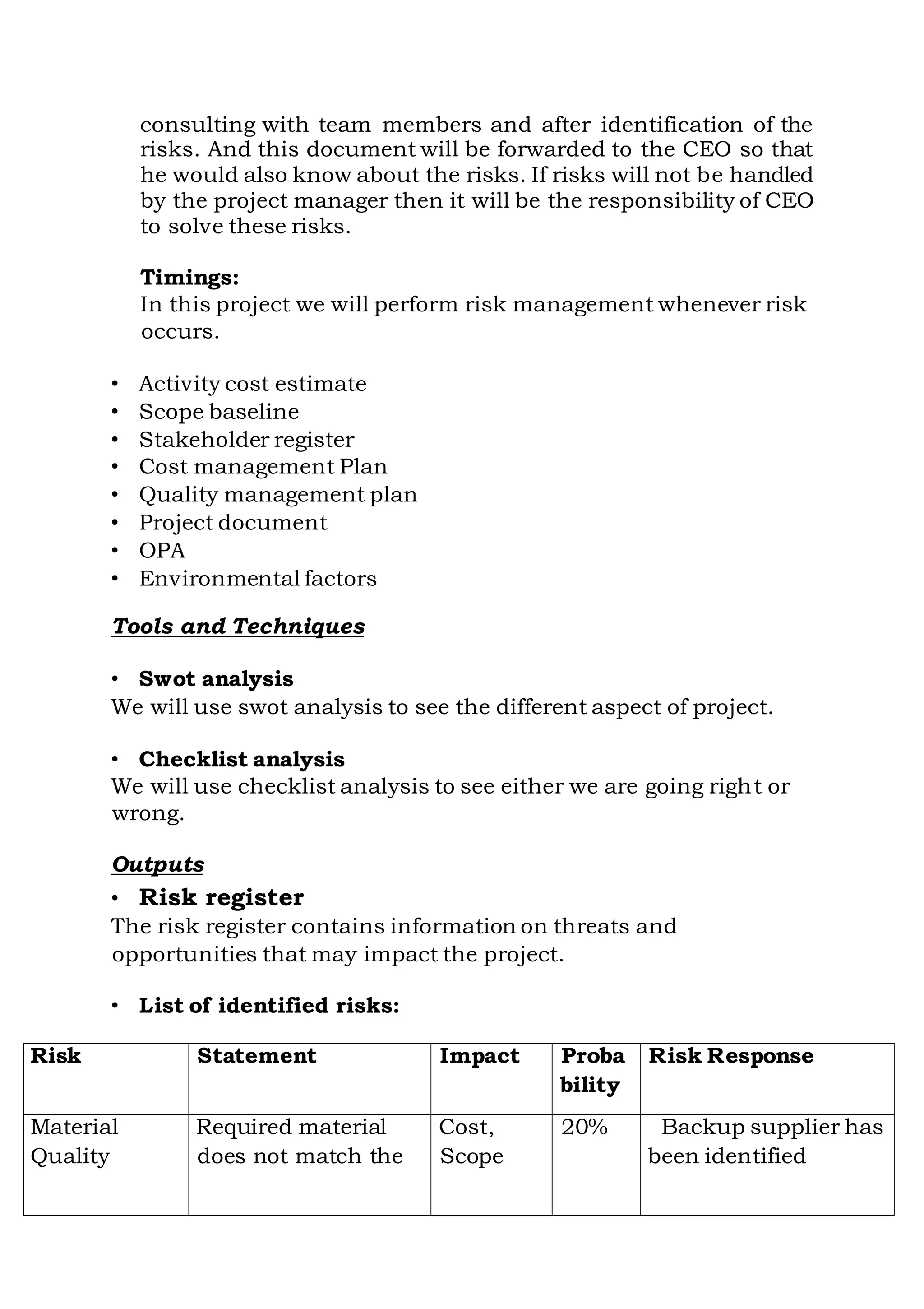

he would also know about the risks. If risks will not be handled
by the project manager then it will be the responsibility of CEO
to solve these risks.
Timings:
In this project we will perform risk management whenever risk
occurs.
• Activity cost estimate
• Scope baseline
• Stakeholder register
• Cost management Plan
• Quality management plan
• Project document
• OPA
• Environmental factors
Tools and Techniques
• Swot analysis
We will use swot analysis to see the different aspect of project.
• Checklist analysis
We will use checklist analysis to see either we are going right or
wrong.
Outputs
• Risk register
The risk register contains information on threats and
opportunities that may impact the project.
• List of identified risks:
Risk Statement Impact Proba Risk Response
bility
Material Required material Cost, 20% Backup supplier has
Quality does not match the Scope been identified
quality needed

Availability Material, does not Time 10% Reserve extra
available at required Scope material to handle
time this risk
Inflation Increase in the price Cost 30% Reserve some extra
of materials Time money for this risk
management
Labour strike Labour strike due to Time, 10% Give good pay and any
problem Scope benefits so that this
risk can be manage
Natural Earth quake, flood Cost, 2% Start the project
disaster etc Scope, again
Time
Stakeholder Change the Quality, 15% Taking notice on their
requirement, or may Time, requirements and be the project Cost work
again to fulfil progress is not up to their new their expectations
requirements Software System does not Cost, 10% Purchase
new system
failure work Schedule
Machinery Machinery does not Cost, 25% Purchase new failure
work properly Quality, machinery, or backup schedulemachinery
Load Electricity work Cost, 20% Purchase generator shedding affected and
Schedule
machinery does not
work due to load
shedding

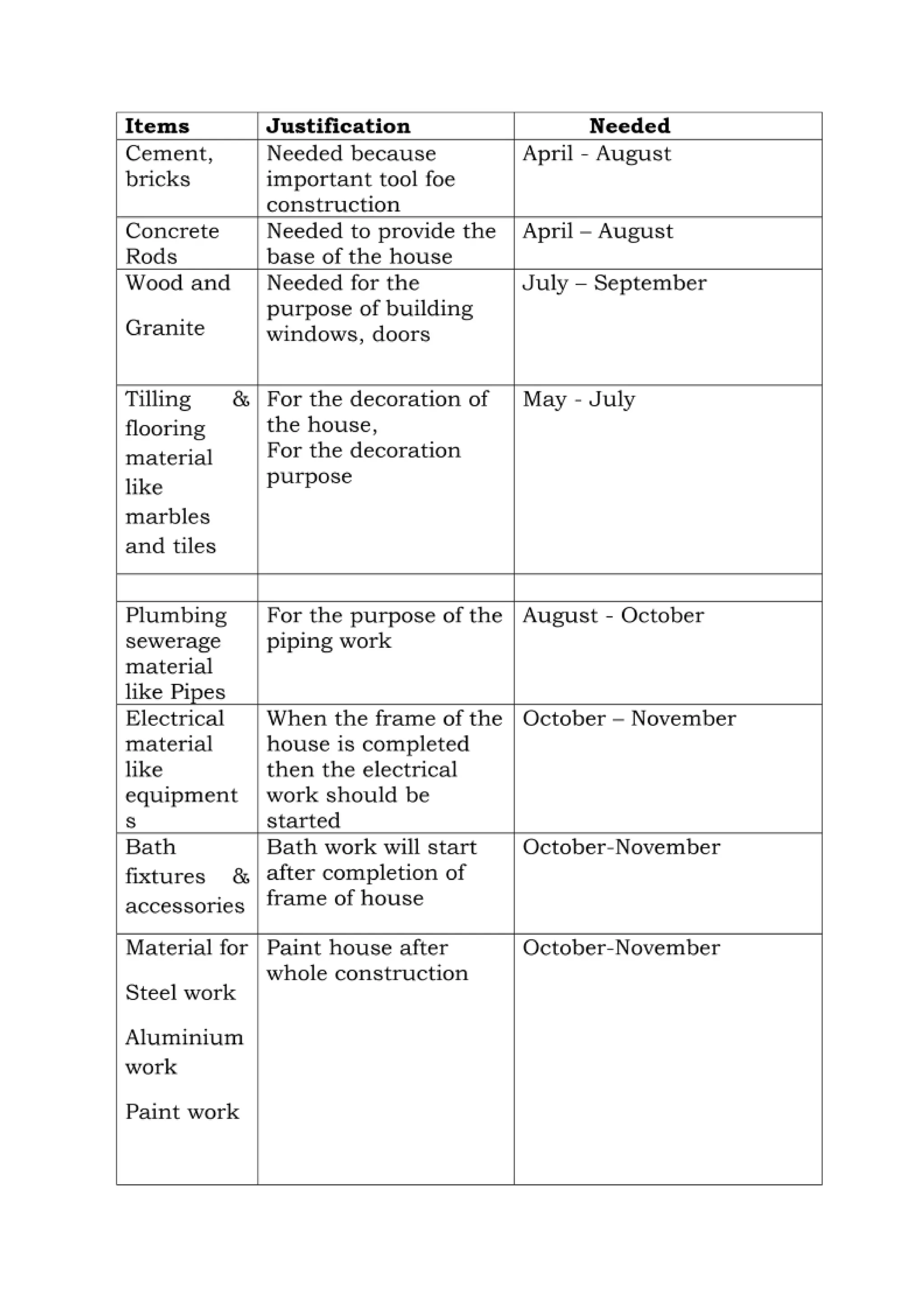

PROJECT PROCUREMENT MANAGEMENT PLAN
Plan procurements
Plan procurement contains the process of documenting project
purchasing decisions, specifying the approach, and identifying
potential sellers.

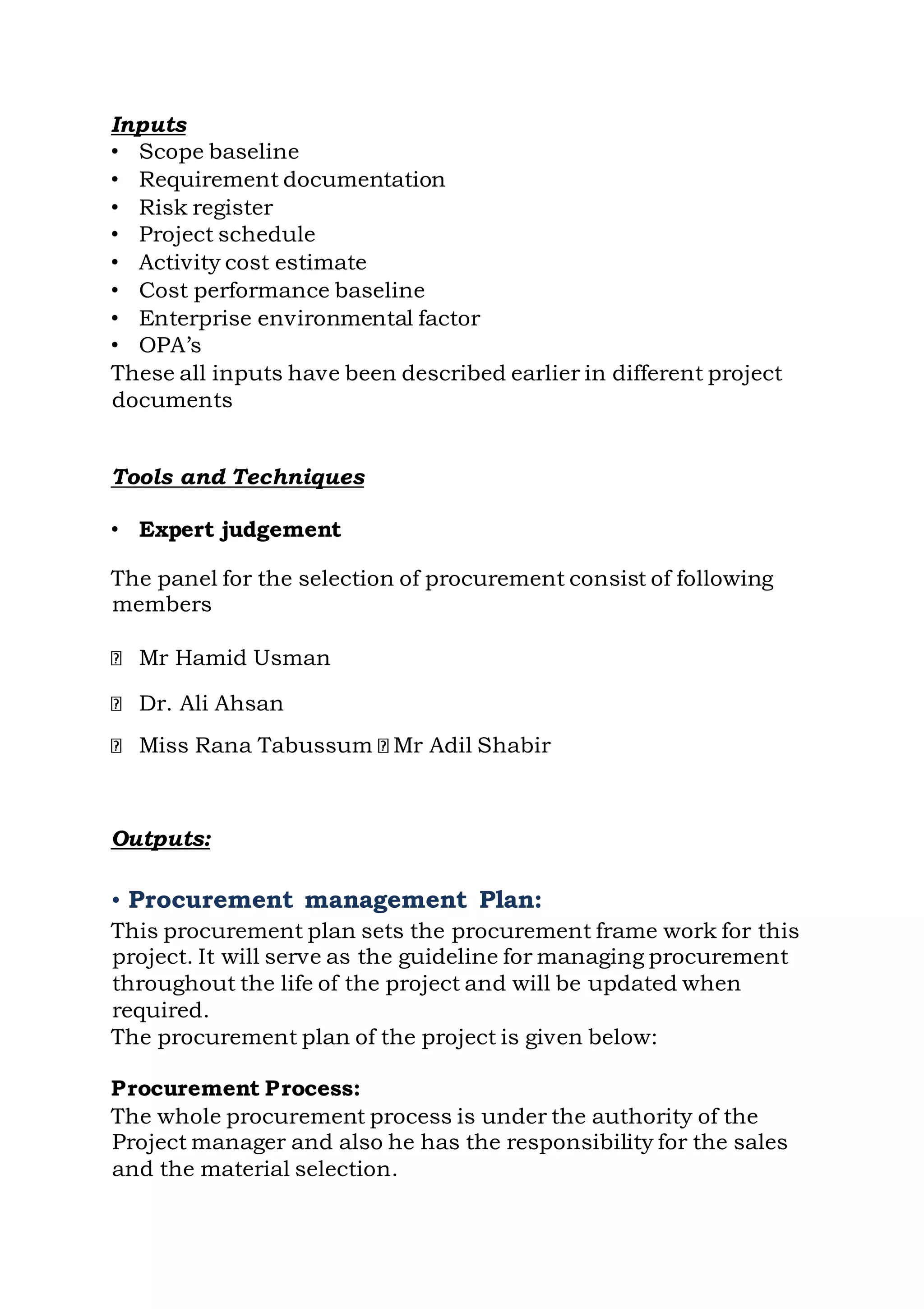

Inputs
• Scope baseline
• Requirement documentation
• Risk register
• Project schedule
• Activity cost estimate
• Cost performance baseline
• Enterprise environmental factor
• OPA’s
These all inputs have been described earlier in different project
documents
Tools and Techniques
• Expert judgement
The panel for the selection of procurement consist of following
members
Mr Hamid Usman
Dr. Ali Ahsan
Miss Rana Tabussum Mr Adil Shabir
Outputs:
• Procurement management Plan:
This procurement plan sets the procurement frame work for this
project. It will serve as the guideline for managing procurement
throughout the life of the project and will be updated when
required.
The procurement plan of the project is given below:
Procurement Process:
The whole procurement process is under the authority of the
Project manager and also he has the responsibility for the sales
and the material selection.
Make or buy decisions:
We are outsourcing some of the project materials and also this
step is important in because the decision for buying or not
buying is totally based upon the fact that the project manager
give the green signal to the supplier. Then the process of the
procurement is started.

Project Management Report

  • 1.
    Project Management Final ProjectReport For Construction of a House By: Sanket Senapati Roll No. 16202284 Purpose of the Project The purpose of this project was to analyze project in the light of terms of managing project explained by lectures and PMBOK.
  • 2.
    Brief description ofproject Royal Construction is a reliable company in house construction. It has been active in construction project for the last 20 years. The main aim of this company is to fulfil the needs of customers and satisfy them by providing the best possible outcome. We provide a luxurious life to our customer at reasonable price. Recently our company signed a contract of construction of house in Bahria town phase 8 with Mr Ali. Mr Ali Hamza. He floats a tender about the new house construction with specify the requirements. And choose our company for this project because we provide a reliable house at reasonable cost. The duration decided for this project is one year with basement, ground floor and first floor. And the cost for this project is 14,365,047.All this description is written in the contract and both of the parties signed this agreement. Initiation of the project The Initiation Process consists of those processes performed to define a new project or a new phase of an existing project by obtaining agreement to start the project or phase. Within the initiatingprocesses, the initial scope is defined and initial financial resources are committed. Internal and external stakeholders who will interact and influence the overall outcome of the project are identified. Or in simple word we can say that in this first phase of the project the project charter and the stakeholders are identified. Develop Project Charter Develop Project Charter is the process of developing a document that formally authorizes a project or a phase and documenting initial requirements that satisfy the stakeholder’s needs and expectations. Project charter The charter contains the brief description of the project. Different inputs are used to develop project charter and these inputs are;
  • 3.
    Inputs 1. Contract: A contractis a legal agreementbetween two parties. For our project a contract is signed between Mr Ali and a company’s CEO Mr Hamid Usman. In this contract duration, cost plan, project plan, procurement plan are mentioned. • Duration Start date 1st January 2017 End date 31 December 2017 • Duration of different processes Initiation 1st Jan- 31 Jan (1month) Planning 1nd Feb- 30 Mar (2months) Execution 1st Apr - 25 Nov (8months) Monitoring and control M&C for whole execution Closing 1st Dec- 31 Dec (1month) • Cost Plan
  • 4.
    Work Cost Pluming material Concreterods Paint Flooring material Electrical equipment Glass windows Wood Cement Bricks Labor • "Rs794,000.00" • "Rs316,000.00" • "Rs420,000.00" • "Rs3,030,500.00" • "Rs2,328,892.00" • "Rs32,500.00" • "Rs2,086,288.00" • "Rs1,086,200.00" • "Rs1,673,500.00" • "Rs2,310,147.00" Total Cost Human • 14,078,027 • 187,020 Reserve • 100,000 Total Price • 14,365,047
  • 5.
    • Estimated Budget Inthis project keeping all expenses in mind I can say that the estimated budget require for this project is 15,254,350. • Procurement plan All the material mentionedin the costplan is goingto procure from different suppliers at given cost. And this material will purchase before 1st May. 2. Enterprise environmental factors: Environmental factors which may influence this project are Organization Culture Work hour Holidays Internal factors like labour strike, shortage of material, unavailability of man power, etc. External factors like load shedding, public strike against any event, political factors, inflation etc. 3. Organizational process assets: OPA provide us a guideline and give us a procedures that how to work on this construction project. We will follow these procedures in future for the house construction. Our past history also helps us to do project in a good way. Output Project charter • Background There are many construction companies in Pakistan but Royal Company made a good name in the construction industry. This company is well known among people because it provided the best result to its customers. This companypromise to deliverthe result according to customer want or needs. As the population increases the need for good living standard also increases. People want different and stylish house for living so we recently signed a new contract of house construction in Behria Town.
  • 6.
    • Description ofProject For this project Ali Hamza selected our company for construction of his own house. Different terms and conditions with the time duration of the project are written in the contract. Triple constraint The triple constraint consists of time, scope and cost. The objective of this project is to achieve the triple constraint. Our 1st focus in this project is to complete the construction with in one year as mentioned in the contract. For this purpose we construct a table and distribute our project phases in different months. Initiation 1st Jan- 31 Jan (1month) Planning 1nd Feb- 3o Mar (2months) Execution 1st Apr - 25 Nov (8months) Monitoring and control M&C for whole execution Closing 1st Dec- 31 Dec (1month) The 2nd focus is to achieve the target with in given budget and for this purpose the cost for different material is already estimated so that we would not exceed from the given budget. The estimated budget is 14,365,047 and in these 14,365,047 all procurementwill done in future for the 1 canal house with basement, ground and 1st floor. The 3rd important factor in this project is scope identification. Scopeof this projectis to construct house with in given time and budget. Scope tells about the requirement of the project. Like in our project different dimensions are mention in scope statement for example,
  • 7.
    Other than thisinformation the time taken to complete these is also mention in the scope statement. We will try to not exceed from our scope and finishing the project with in the time and costing limit. • Project Team Project team is also made for this project and these are 1. Project Manager Mr. Rudra Pratap Mr. Manoj Kumar 2. Team Leader Mr. Dusmanta Singh 3. Team Members Mr. Sujit Mr. Biki Mr. Rana Mrs. Asima Khan Miss. Sabita Malik 4. Assistants Mr. Bikash Patel Mr. Priyaranjan Panda Mrs. Jayashree Number of rooms 15 Number of kitchens 3 Number of bath rooms 12 Loan 1 Terrace 1 Garage 1
  • 8.
    Stakeholders: Our main stakeholderis our customer who s Ali Hamza, then our suppliers. These are the outsider’s stakeholders. With in the company Project charter has a key stake in this project so project manager is a stakeholder and the whole Royal Constructions. Identify stakeholders Identify Stakeholders is the process of identifying all people or organizations impacted by the project or people who are the stake in the project is stakeholder. Inputs All inputs are discussed above in Develop project charter. And these are: • Project charter • Enterprise environment factors • Organizational process assets Tools and Techniques Different tools and techniques are also used to identify stakeholder like stakeholder analysis and expert judgement. • stakeholder analysis Our key stakeholder include Mr. Akhaya Ratha Royal company Vendors/supplies • Expert judgement We are using some experts to analyse stakeholders and these experts are Mrs. Rosa Usman Mrs. Sunita Kumari Mr. Abdul Output • Stakeholder register: Stakeholder Role Involvement priority impact name Ali Customer High Main Positive
  • 9.
    A.G supplier SupplierMedium Main Positive Royal Contractor Medium Main Positive construction Manoj Kumar Project manager Very high Main Very positive • Stakeholder management strategy: Use to increase support of stakeholders by giving them information about project Stakeholder Information given to the stakeholders name Ali Monthly progress of the project. Project performance. Information about the risks involved in project. A.G supplier Monthly progress of the project. Project performance. Information about the risks involved in project. Planning for the project The Planning consists of those processes performed to establish the total scope, define and refine the objectives, and develop the course of action required to attain those objectives. The planning processes develop the project management plan and the project documents that will be used to carry out the project. Planning process group: Planning process group consist of 20 sub-processes. Starting from the develop project management plan and end at procurement. Develop project plan Develop Project Management Plan is the process of documenting the actions necessary to define, prepare, integrate, and coordinate all subsidiary plans. The project management plan defines how the project is executed, monitored and controlled, and closed.
  • 10.
    Inputs All the inputsfor the development of project plan are mentioned above. And the same tool & technique is used for this process and it is expert judgement mentioned in the initiation phase. Outputs • Project management plan Other then life cycle all these parts of the plan explained later step by step. • Scope management plan • Requirements management plan • Schedule management plan • Cost management plan • Quality management plan • Process improvement plan • Human resource plan • Communications management plan • Risk management plan • Procurement management plan Life cycle Total duration year1 Start 1st Jan End Dec31 Initiation 1st Jan- 31 Jan (1month) Planning 1nd Feb- 31 Mar (2months) Execution 1st Apr- 25 Nov (8months) Monitoring and control M&C for whole execution Closing 1st Dec- 31 Dec (1month)
  • 11.
    PROJECT SCOPE MANAGEMENTPLAN Collect Requirement Collect Requirements is the process of defining and documenting stakeholders’ needs to meet the project objectives. Input • Project charter: Project charter is already described in the document. • Stakeholder register: Stakeholder Role Involvement priority impact name Ali Customer High Main Positive Supplier/vender Supplier Medium Main Positive Royal Contractor High Main Positive Construction Manoj Project Manager Very High Main Very Positive Tools and Techniques • Interview or face to face meeting: In this project we only conduct the face to face meeting or interview with our stakeholders to get the information about their interest in this project. Output • Requirement Management Plan: Stakeholders Requirements Criteria Ali Hamza Project to be Customer satisfaction, project Customer completed on execution with good utilization of time monetary and other type of resources in the form of time and human resource Royal construction Satisfy customer -------------- Company by providing good result
  • 12.
    Vendors/suppliers Supply thingson -------------time and get money Ali Project to be Success of the project as a whole Project Managercompleted on and project completion on time time with the full with excellent utilization of utilization of resource. Also the end productwith material and acceptance from the customer human resource. Define scope Define Scope is the process of developing a detailed description of the project and product. Inputs: • Project charter • OPA’S Both inputs are described above in detail. Tools and Techniques • Expert judgement: Described above • Product analysis: Since the output of the project include the product as deliverable so the product analysis is compulsory. So we will use work break down structure. • Alternative identification: Identifying alternatives is a technique used to generate different approaches to execute and perform the work of the project. So we will use pair with comparison technique if we will go out of the scope, we will compare our project techniques with the previous project.
  • 13.
    Outputs • Scope Statement: Themain goal of this project is to construct house with in one year by analysing the stakeholders’ needs and interests. Create WBS Create WBS is the process of subdividing project deliverables and project work into smaller, more manageable components. In this project we will break down the house into many small components. Inputs: (Already discussed) Project scope statement Requirement document Organizational process assets Tools and Techniques Decomposition: The tasks and activities are divided in to sub tasks and processes like divide house into smaller parts. Outputs WBS has been made in MS project. • Scope baseline: The scope contains the project description, major project deliverables and acceptance criteria. Main Deliverable Complete house Documents/reports About the monthly progress
  • 14.
    • Description: The durationdecided for this project is one year with basement, ground floor and first floor. And the cost for this project is 15,254,350. All this description is written in the contract and both of the parties signed this agreement. In this part we base line (fix) our project its requirements, deliverables, and the acceptance criteria. PROJECT TIME MANAGEMENT PLAN Define activities The process of identifying the specific actions to be performed to produce the project deliverables Inputs • Scope baseline: The scope contains the project description, major project deliverables and acceptance criteria. Description: The duration decided for this project is one year with basement, ground floor and first floor. And the cost for this project is 15,254,350. All this description is written in the contract and both of the parties signed this agreement. Main Deliverable Complete house Documents/reports About the monthly progress
  • 15.
    Deliverable In thispart we base line (fix) our project its requirements, deliverables, and the acceptance criteria. • Enterprise environmental factors: Environmental factors which may influence this project are Organization Culture Work hour Holidays Internal factors like labour strike, shortage of material, unavailability of man power, etc. External factors like load shedding, public strike against any event, political factors, inflation etc. • Organizational process assets: OPA provide us a guideline and give us a procedures that how to work on this construction project. We will follow these procedures in future for the house construction. Our past history also helps us to do project in a good way. Tools and Techniques Decomposition, Template and expert judgement is gong to be used as a tool. Output • Activity list: Proposal writing Defining team members and group leader. Gathering required information. Performing feasibility analysis. Defining customer requirements. Complete house Documents/reports About the monthly progress
  • 16.
    Develop project charter. Identifyingstakeholders. Collecting requirements. Project Costing. Project Budgeting. Scheduling. Project scope management planning. Project scope statement writing Scope baseline. Defining accepted work deliverables. Project risk management planning. Project communication management planning. Project quality management planning. Project procurement management planning. Whole construction • Milestone list Main task is construction of structure. Mandatory tasks Target date Approval of Charter 31 Jan 2017 Project plan completion 1st Mar 2017 Approval of project plan 15 Mar 2017 Selection of project team 31 Mar 2017 Execution started 1st April 2017 Execution completed 25 Nov 2017 Closing 31 Dec 2017 Sequence Activities Sequence Activities is the process of identifying and documenting relationships among the project activities.
  • 17.
    Inputs • Activity list •Milestone list • Scope statement • Organizational process assets These are already described above in define activity process. Tools and Techniques • Precedence Diagramming Method Precedence diagramming method will used in this project is GANTT. It will contain finish to finish, start to start, finish to start and start to finish relationship of the activities. And it is shown in MS project. Outputs • Project schedule network diagram Gantt Diagram and it is on MS project Estimate Activity Resource Estimate Activity Resources is the process of estimating the type and quantities of material, people, equipment, or supplies required to perform each activity. Inputs • Activity list (mentioned above) • Enterprise Environment factors (mentioned above) • Organizational process assets (mentioned above) • Resource calendar (Has been made in Ms Project) Tools and techniques • Expert judgement (mentioned above) • Alternative analysis (mentioned above)
  • 18.
    Outputs • Activity resourcerequirement plan Type of resource Requirement Human resource For all activities human resources are required to make the project team and utilize labour for project. Software resources Software resources are required to make the design of house. Organizational process asset Organizational process assets contains organization’s policies, templates, standards and help data for the guidance of team members so that they can perform the project processes more efficiently and with better utilization of time and monetary resources. Transportation resources Transportation is required for delivery of material. Materials Different type of material is needed for this project like cement, steel, sand etc Equipment Equipments are also required this project.
  • 19.
    Resource breakdown structure Estimate ActivityDuration Estimate Activity Durations is the process of approximating the number of work periods needed to complete individual activities with estimated resource. Inputs Inputs have been already described earlier. • Activity list • Activity resource requirement • Project scope statement • OPA • Enterprise environment factors Tool and Technique • Expert judgement The panel of experts include Mrs. Rosa Usman Mrs. Sunita Kumari Mr. Abdul
  • 20.
    • Analogous estimationFrom previous project Outputs • Activity Duration Estimate Activity Duration Estimate(days) Project initial proposal writing 2 Defining team members and group leader. 1 Gathering required information. 1 Performing feasibility analysis. 1 Defining customer requirements. 1 Develop project charter. 2 Identifying stakeholders. 1 Collecting requirements. 1 Project Costing. 2 Project Budgeting. 1
  • 21.
    Develop Schedule Develop Scheduleis the process of analyzing activity sequences, durations, resource requirements, and schedule constraints to create the project schedule. Inputs • Activity list • Activity resource requirements • Activity duration estimate • Project scope statement • OPA Scheduling. 1 Project scope management planning. 2 Project scope statement writing. 1 Making project scope baseline. 1 Defining accepted work deliverables. 1 Project risk management planning. 2 Project communication management planning. 2 Project quality management planning. 2 Project procurement management planning. 2 Whole construction 240
  • 22.
    • Environment factors Toolsand Techniques • Resource levelling • Critical Path method It is made in MS project. Output PROJECT COST MANAGEMENT PLAN Estimate Cost Mentioned in MS project also • Project schedule Main tasks Deadlines Foundation 30 April Ground 30 June Basement 30 July Ground floor 25 Sep 1st floor 25 Nov
  • 23.
    Determine Budget Total budgetis 15,254,350 for this project Work Cost Pluming material Concrete rods Paint Flooring material Electrical equipment Glass windows Wood Cement Bricks Labor • "Rs794,000.00" • "Rs316,000.00" • "Rs420,000.00" • "Rs3,030,500.00" • "Rs2,328,892.00" • "Rs32,500.00" • "Rs2,086,288.00" • "Rs1,086,200.00" • "Rs1,673,500.00" • "Rs2,310,147.00" Total Cost Human • 14,078,027 • 187,020 Reserve • 100,000 Total Price • 14,365,047
  • 24.
    PROJECT QUALITY MANAGEMENTPLAN Plan quality Inputs • Scope baseline The scope contains the project description, major project deliverables and acceptance criteria. Description: The duration decided for this project is one year with basement, ground floor and first floor. And the cost for this project is 15,254,350. All this description is written in the contract and both of the parties signed this agreement. Main Deliverable In this part we base line (fix) our project its requirements, deliverables, and the acceptance criteria • Stakeholder register Ali Customer High Main Positive Supplier/vender Supplier Medium Main Positive Royal Contractor High Main Positive Construction Rudra Project Manager Very High Main Very Positive • Cost Performance baseline The cost performance is an authorized time phased budget at completion used to measure, monitor and overall cost performance on project. Complete house Documents/reports About the monthly progress Stakeholder name Role Involvement priority impact
  • 25.
    • Schedule Baseline Thisis the accepted schedule performance measures including start and finish dates. Tools and Techniques • Cost benefit analysis The benefit of meeting quality requirements can include less rework, higher productivity, lower cost and increased stakeholder satisfaction. Outputs • Quality management plan The quality management plan describes how the project management team will implement the performing organization’s quality policy. Quality Role: Responsibilities 1. Project Cost Efficiency. 2. Procure good quality material. 3. Manage quality of material 4. Project schedule. 5. Product overall working. 6. Allocation of resources at time Perform Quality approach 1. Finance Department, Quality Department, Project Manager, Project Team. 2. Project manager 3. Project Team. 4. Project Manager, Quality Department. 5. Project Manager, Project Team. 6. project manager Planning quality and performing quality control will be used to analysis the work of the management processes continuously, and the product related processes to alleviate negative impacts and check the cost and schedule variances. The reports will also make and these reports will show the project’s performance and quality standard.
  • 26.
    Quality control approach Weeklycost performance reports will be issued and help will be sought from Finance department to reduce costs on project. Inspection, Control Charts and Scatter plot will be made to analyze project, team members and schedule performance. Quality improvement approach To improve the quality of the project’s processes many steps will be used like: • Weekly meeting will be called between the project manager and project team so that difficulties which might be affect the project will be removed. • Reports on cost performance will be issued weekly to analyse the cost against quality. • Control Charts and Scatter plot will be made to analyze project, team members and schedule performance. PROJECT HUMAN RESOURCE MANAGEMENT PLAN • Develop Human Resource Plan Project Human Resource Management includes the processes that organize, manage, and lead the project team. Inputs • Activity resource requirements The resources will be provided according to the need. And the resource requirement documentation for each activity will include the estimated resources for each activity. • OPA • Enterprise environmental factors
  • 27.
    Tools and techniques •Networking Networking is the formal and informal interaction with others in an organization, industry, or professional environment. For this project we will call the meetings weekly with the project manager and with company CEO monthly. • Organizational theory Organizational theory will provide us information regarding the way in which people, teams, and organizational units behave. Outputs • Human Resource plan Projects teams Roles, Responsibilities, and Authority of project team: Selection of workers: After mentioning the roles of the project team, the worker team will be selected based upon the needs of the project. In the project of construction the worker team will be selected on the basis of experience.
  • 28.
    PROJECT RISK MANAGEMENTPLAN Plan Risk Management The processes of defining how to conduct risk management activities for a project are described in Risk management plan. Inputs • Project scope statement • Cost management plan Work Cost
  • 29.
    • Communication plan/scheduling plan Stakeholders Communication Medium Schedule Mr Ali Monthly Face to face/Email Suppliers Monthly Face to face Pluming material Concrete rods Paint Flooring material Electrical equipment Glass windows Wood Cement Bricks Labor • "Rs794,000.00" • "Rs316,000.00" • "Rs420,000.00" • "Rs3,030,500.00" • "Rs2,328,892.00" • "Rs32,500.00" • "Rs2,086,288.00" • "Rs1,086,200.00" • "Rs1,673,500.00" • "Rs2,310,147.00" Total Cost Human • 14,078,027 • 187,020 Reserve • 100,000 Total Price • 14,365,047
  • 30.
    Royal Construction Weeklywith the Face to face/ Project Manager Presentations Rudra Weekly Face to face/ Email/ Presentations Tools and Techniques • Planning meeting and analysis Attendees at these meetings include project manager, project team members and stakeholders. 1. Risk management cost 2. Risk management schedule activity Outputs • Risk management plan Methodology: In case of any risk we will be called on meetings between the project manager and project team. First of all we analyze the impact of rick on project, and then decide what method is the best to cater the risk. Approaches: High-level plans for conducting the risk management activities will be defined in meetings. Risk management cost elements and schedule activities will be developed. Risk contingency reserve application approaches may be established or reviewed. Risk management responsibilities will be assigned. General organizational templates for risk categories and definitions of terms such as levels of risk, probability by type of risk, impact by type of objectives, and the probability and impact matrix will be tailored to the specific project. Roles and responsibilities: All the project team will be responsible for risk handling. Every group member can play the role of identifying risks, but it is the responsibility of the project manager to focus on the main risks which might occur a big problem for the project. The formal
  • 31.
    document will beprepared by the project manager after consulting with team members and after identification of the risks. And this document will be forwarded to the CEO so that he would also know about the risks. If risks will not be handled by the project manager then it will be the responsibility of CEO to solve these risks. Timings: In this project we will perform risk management whenever risk occurs. Identify risks Identify Risks is the process of determining which risks may affect the project and documenting their characteristics. Inputs • Risk management plan Methodology: In case of any risk we will be called on meetings between the project manager and project team. First of all we analyze the impact of rick on project. and then decide what method is best for cater the risk. Approaches: High-level plans for conducting the risk management activities will be defined in meetings. Risk management cost elements and schedule activities will be developed. Risk contingency reserve application approaches may be established or reviewed. Risk management responsibilities will be assigned. General organizational templates for risk categories and definitions of terms such as levels of risk, probability by type of risk, impact by type of objectives, and the probability and impact matrix will be tailored to the specific project. Roles and responsibilities: All the project team will be responsible for risk handling. Every group member can play the role of identifying risks, but it is the responsibility of the project manager to focus on the main risks which might occur a big problem for the project. The formal document will be prepared by the project manager after
  • 32.
    consulting with teammembers and after identification of the risks. And this document will be forwarded to the CEO so that he would also know about the risks. If risks will not be handled by the project manager then it will be the responsibility of CEO to solve these risks. Timings: In this project we will perform risk management whenever risk occurs. • Activity cost estimate • Scope baseline • Stakeholder register • Cost management Plan • Quality management plan • Project document • OPA • Environmental factors Tools and Techniques • Swot analysis We will use swot analysis to see the different aspect of project. • Checklist analysis We will use checklist analysis to see either we are going right or wrong. Outputs • Risk register The risk register contains information on threats and opportunities that may impact the project. • List of identified risks: Risk Statement Impact Proba Risk Response bility Material Required material Cost, 20% Backup supplier has Quality does not match the Scope been identified
  • 33.
    quality needed Availability Material,does not Time 10% Reserve extra available at required Scope material to handle time this risk Inflation Increase in the price Cost 30% Reserve some extra of materials Time money for this risk management Labour strike Labour strike due to Time, 10% Give good pay and any problem Scope benefits so that this risk can be manage Natural Earth quake, flood Cost, 2% Start the project disaster etc Scope, again Time Stakeholder Change the Quality, 15% Taking notice on their requirement, or may Time, requirements and be the project Cost work again to fulfil progress is not up to their new their expectations requirements Software System does not Cost, 10% Purchase new system failure work Schedule Machinery Machinery does not Cost, 25% Purchase new failure work properly Quality, machinery, or backup schedulemachinery Load Electricity work Cost, 20% Purchase generator shedding affected and Schedule machinery does not work due to load shedding PROJECT PROCUREMENT MANAGEMENT PLAN Plan procurements Plan procurement contains the process of documenting project purchasing decisions, specifying the approach, and identifying potential sellers.
  • 34.
    Inputs • Scope baseline •Requirement documentation • Risk register • Project schedule • Activity cost estimate • Cost performance baseline • Enterprise environmental factor • OPA’s These all inputs have been described earlier in different project documents Tools and Techniques • Expert judgement The panel for the selection of procurement consist of following members Mr Hamid Usman Dr. Ali Ahsan Miss Rana Tabussum Mr Adil Shabir Outputs: • Procurement management Plan: This procurement plan sets the procurement frame work for this project. It will serve as the guideline for managing procurement throughout the life of the project and will be updated when required. The procurement plan of the project is given below: Procurement Process: The whole procurement process is under the authority of the Project manager and also he has the responsibility for the sales and the material selection.
  • 36.
    Make or buydecisions: We are outsourcing some of the project materials and also this step is important in because the decision for buying or not buying is totally based upon the fact that the project manager give the green signal to the supplier. Then the process of the procurement is started.
