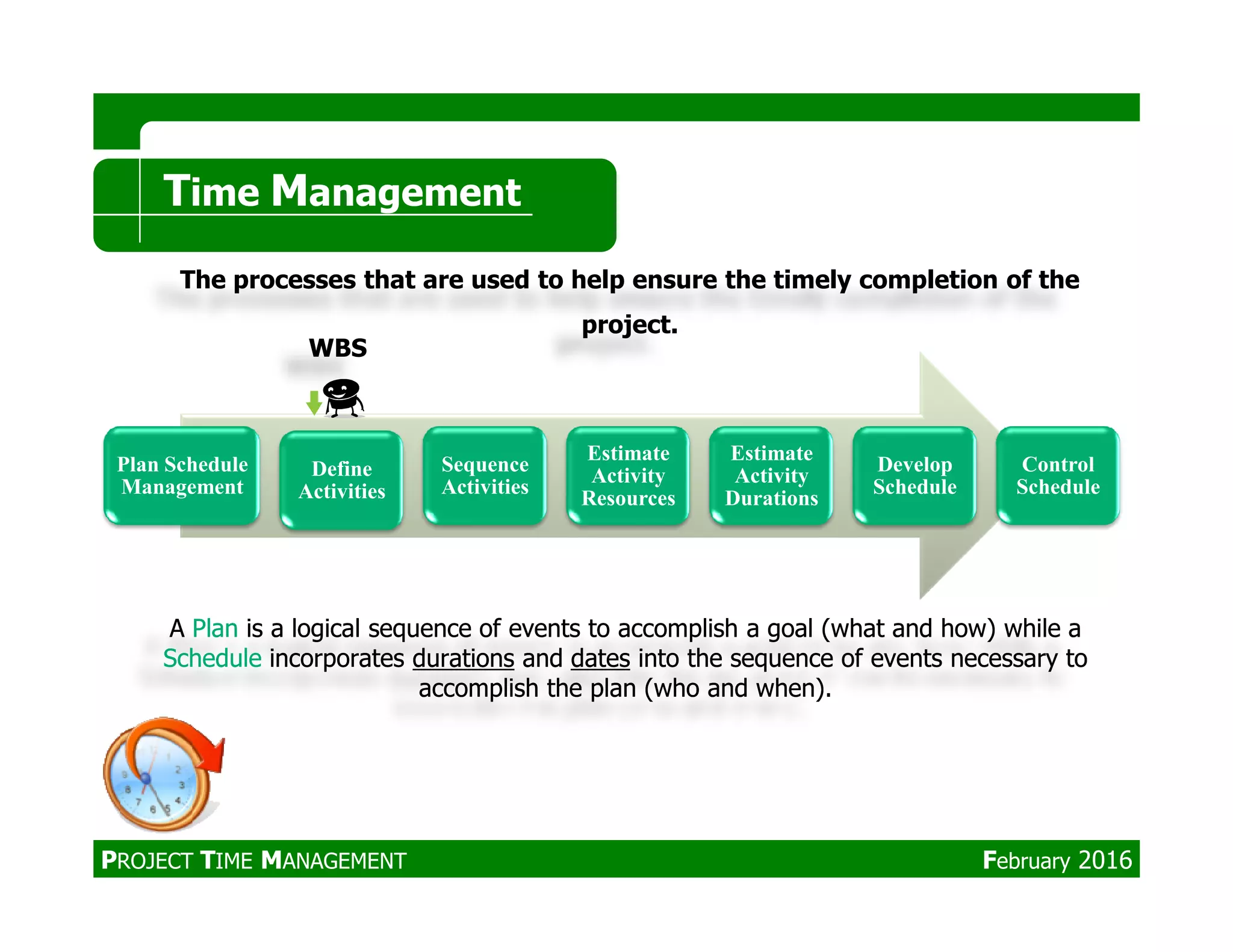

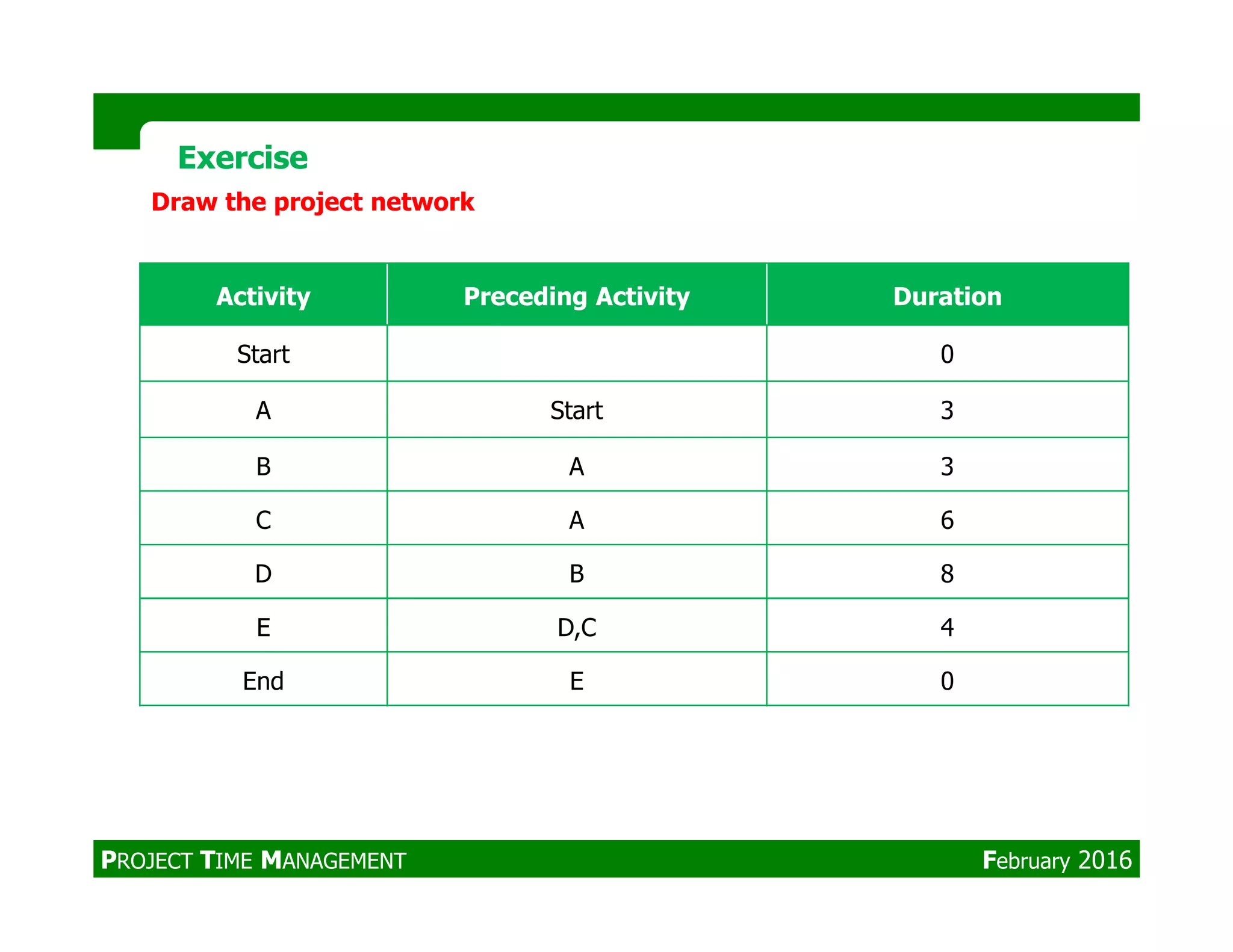

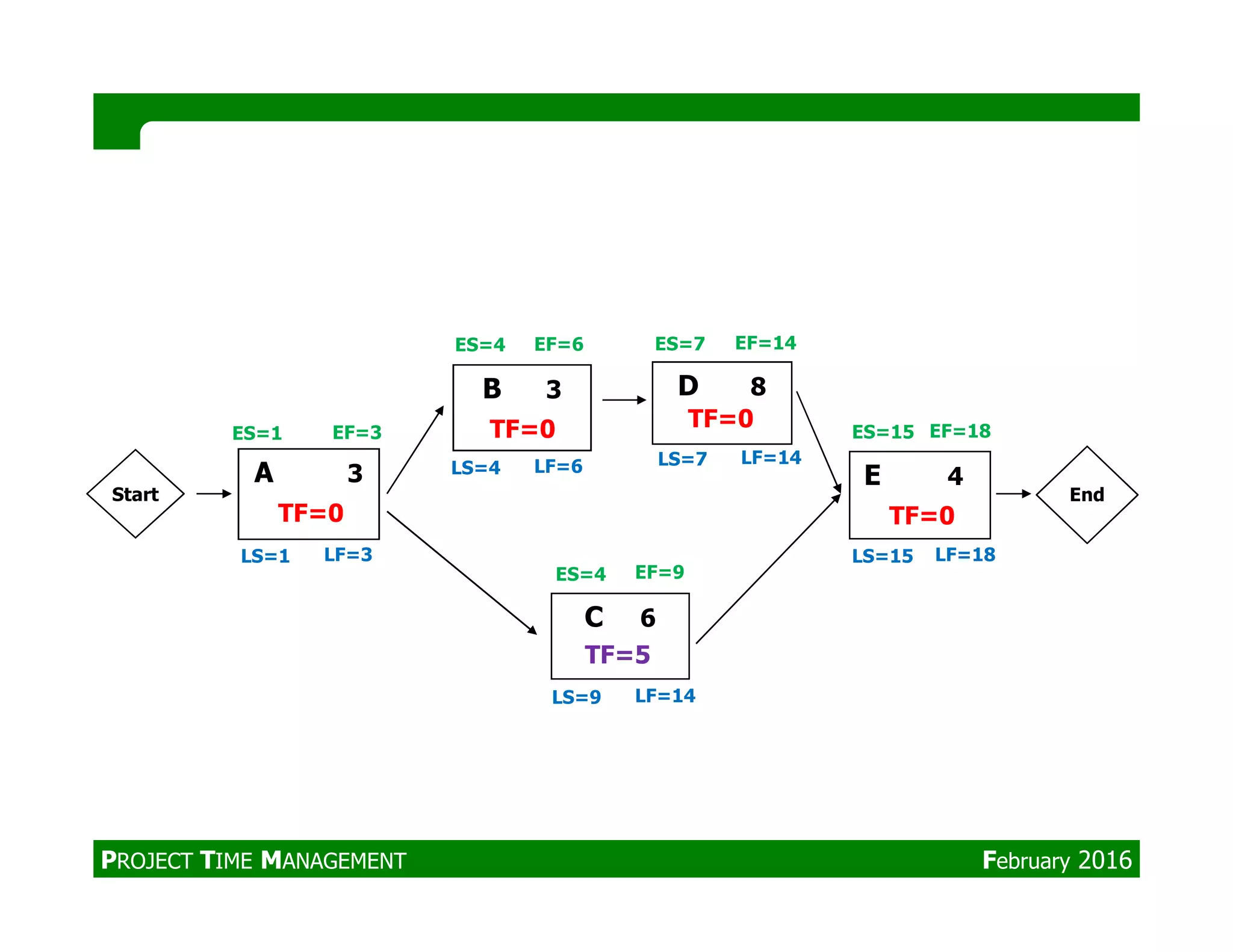

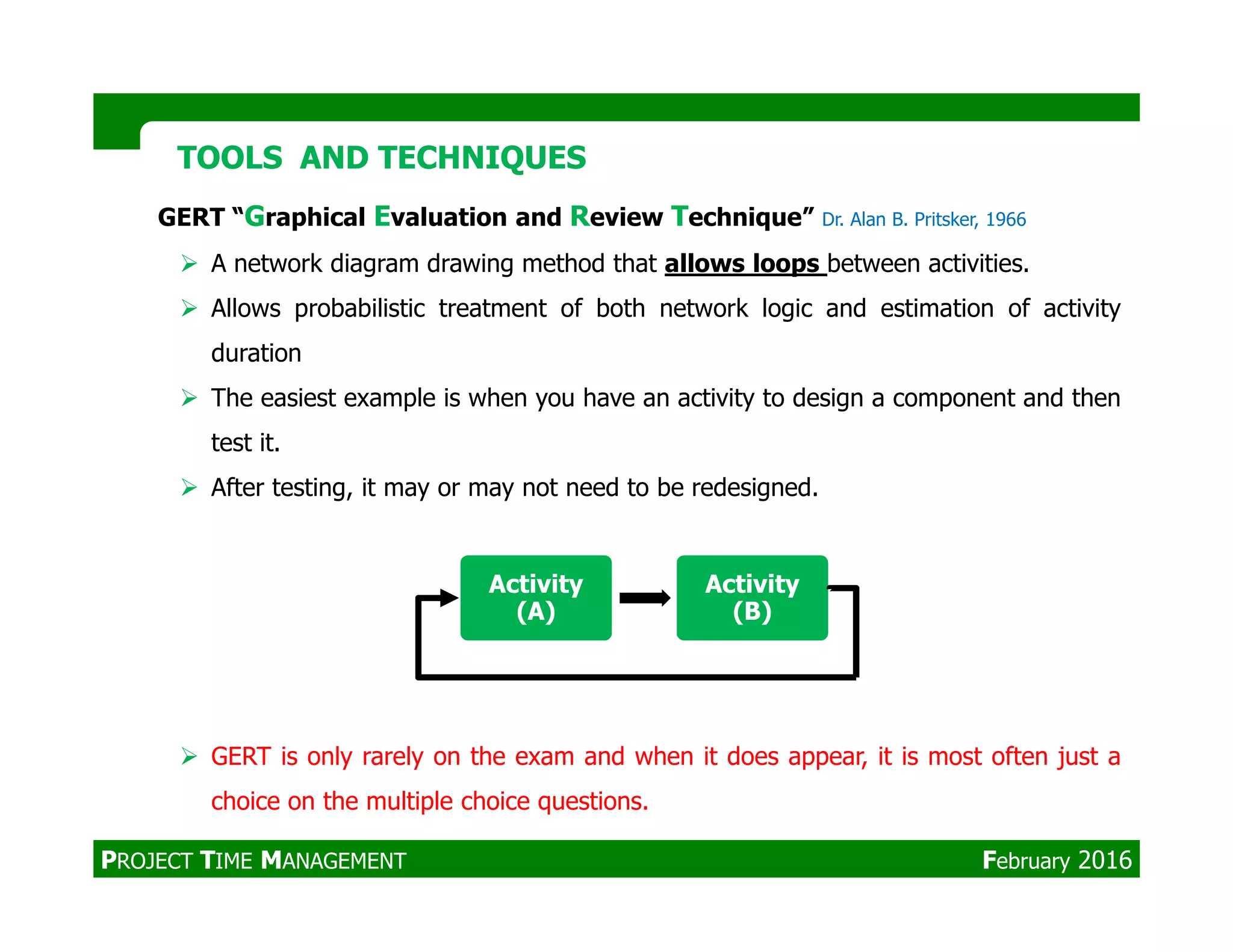

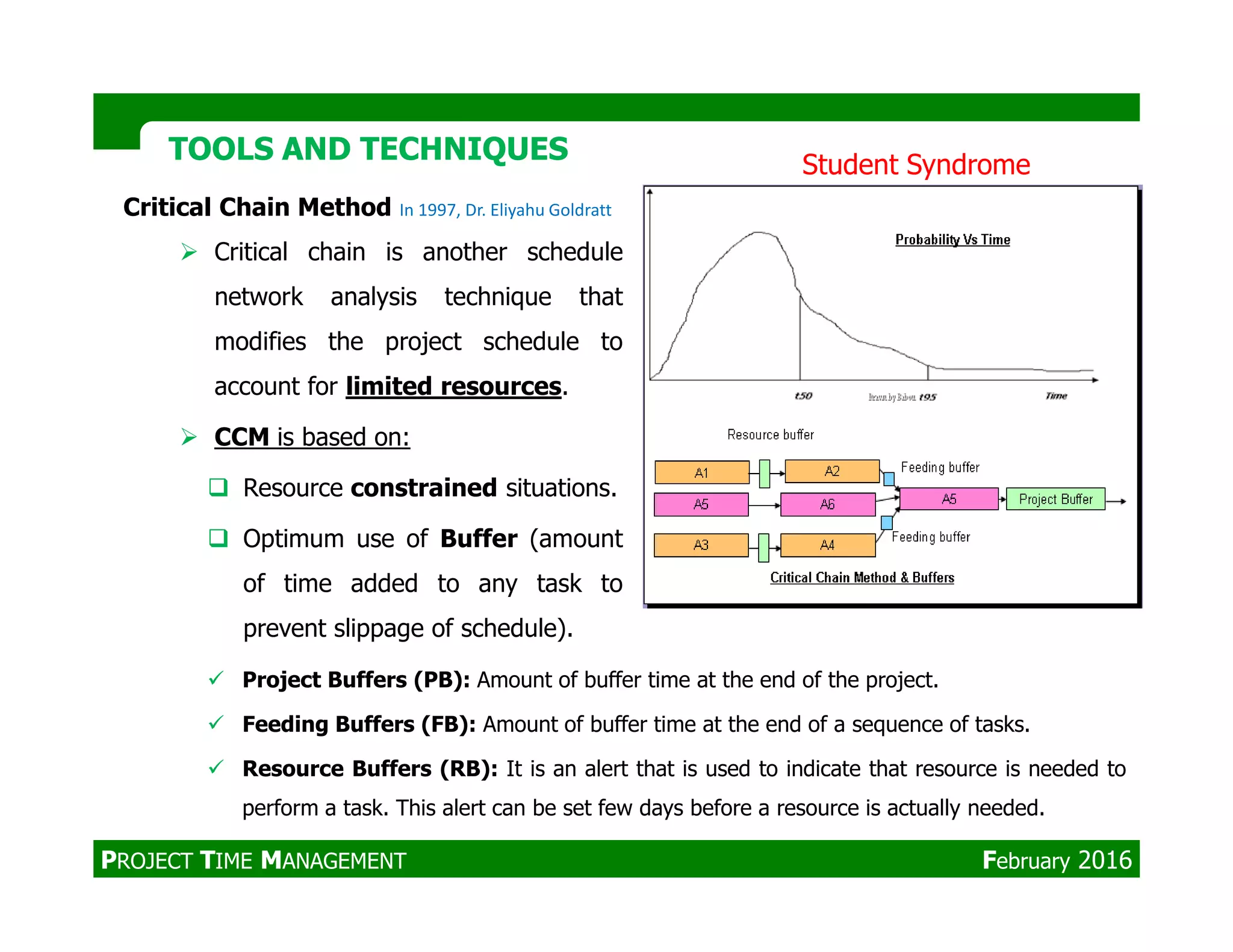

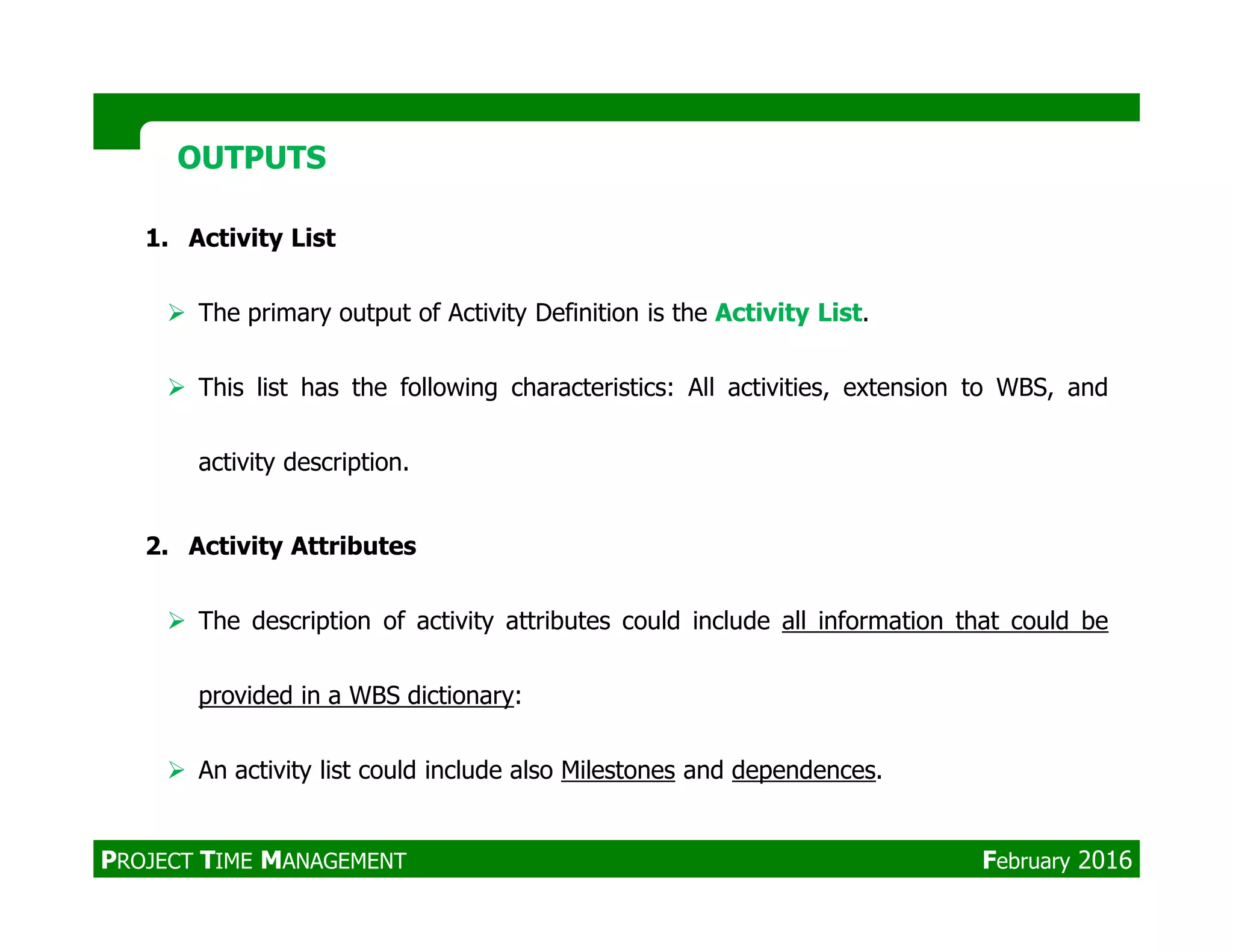

The document discusses project time management processes. It provides details on defining activities, sequencing activities, and estimating activity resources. The key processes covered are:

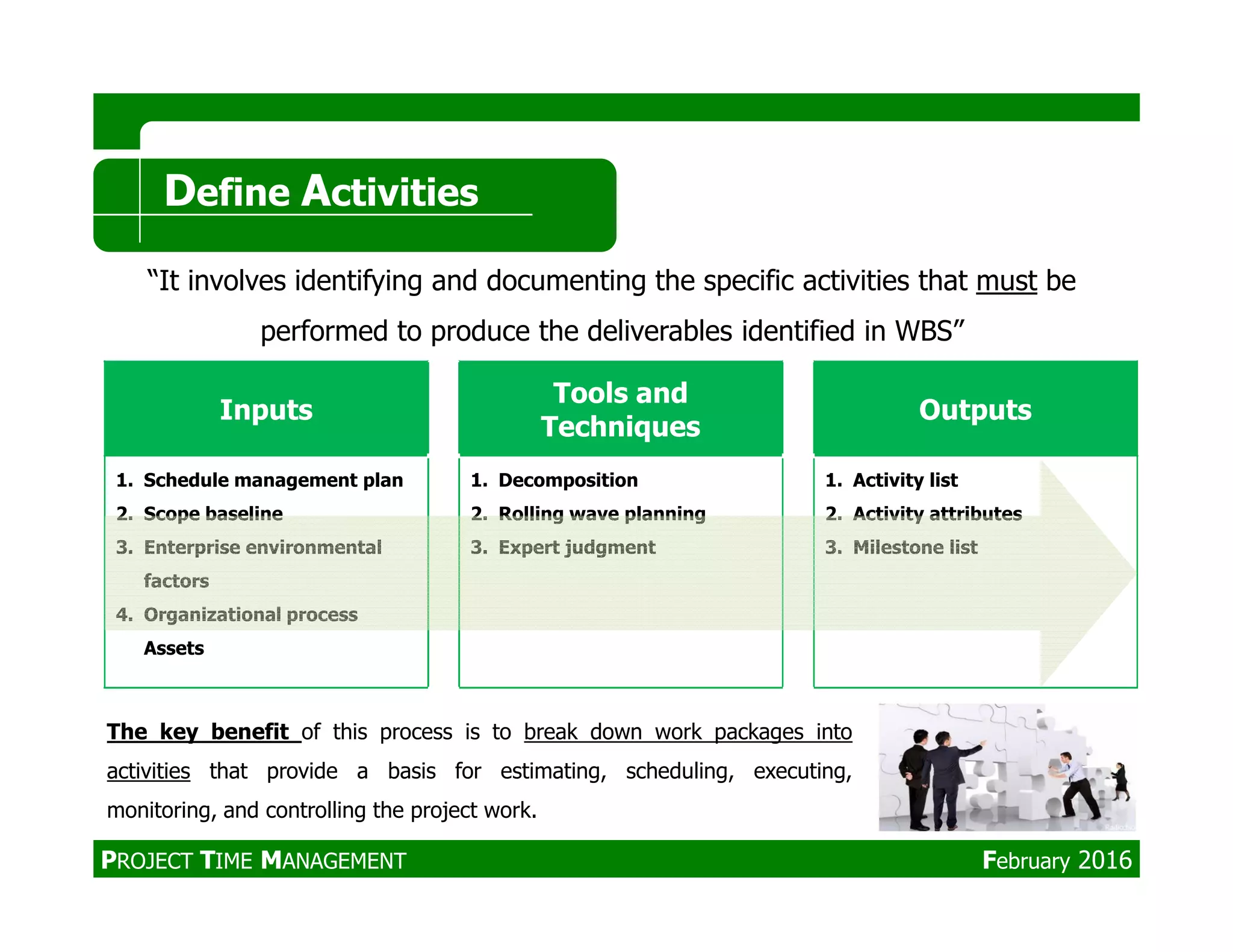

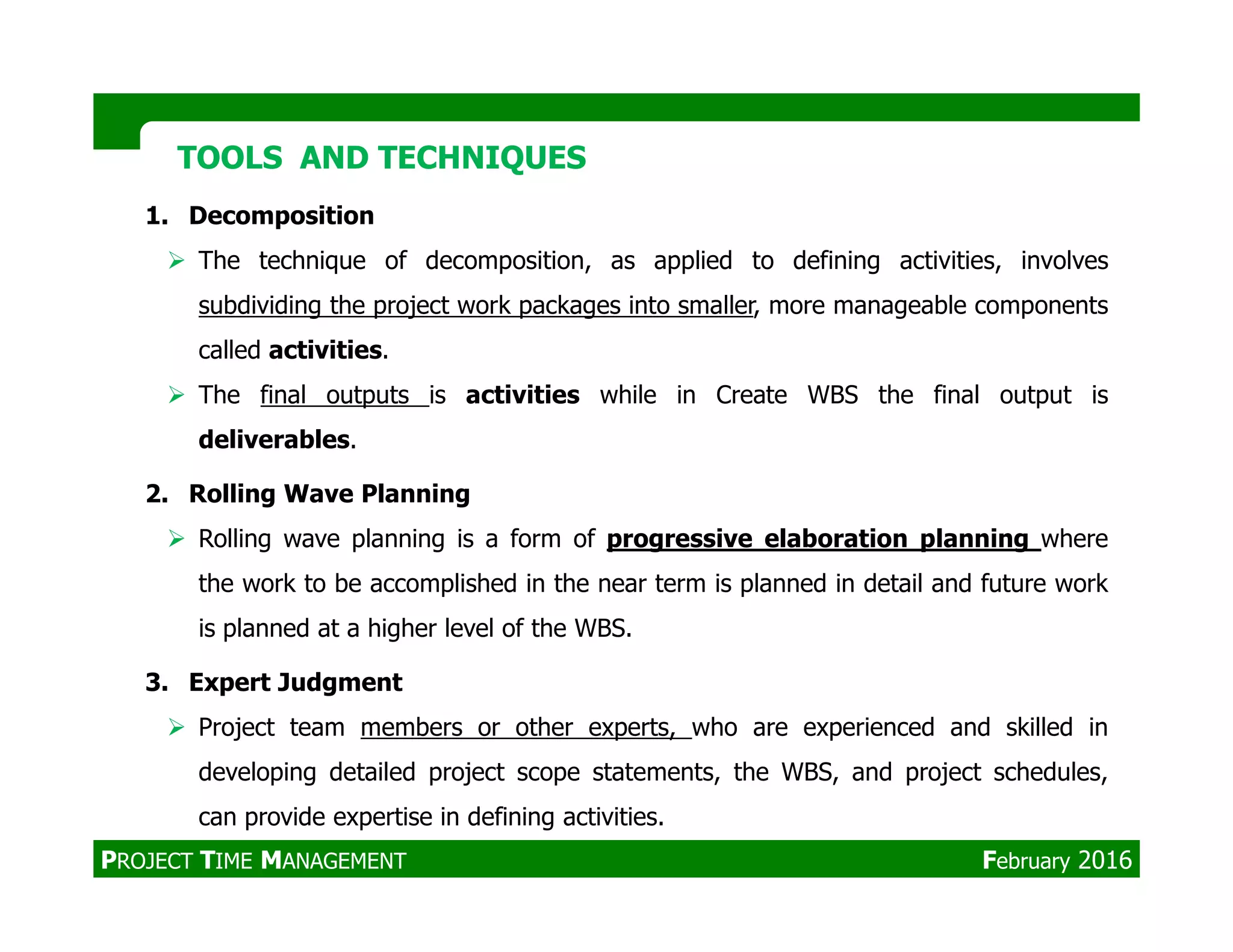

- Define activities by breaking work packages into smaller activities that provide a basis for estimating, scheduling, executing, and controlling work.

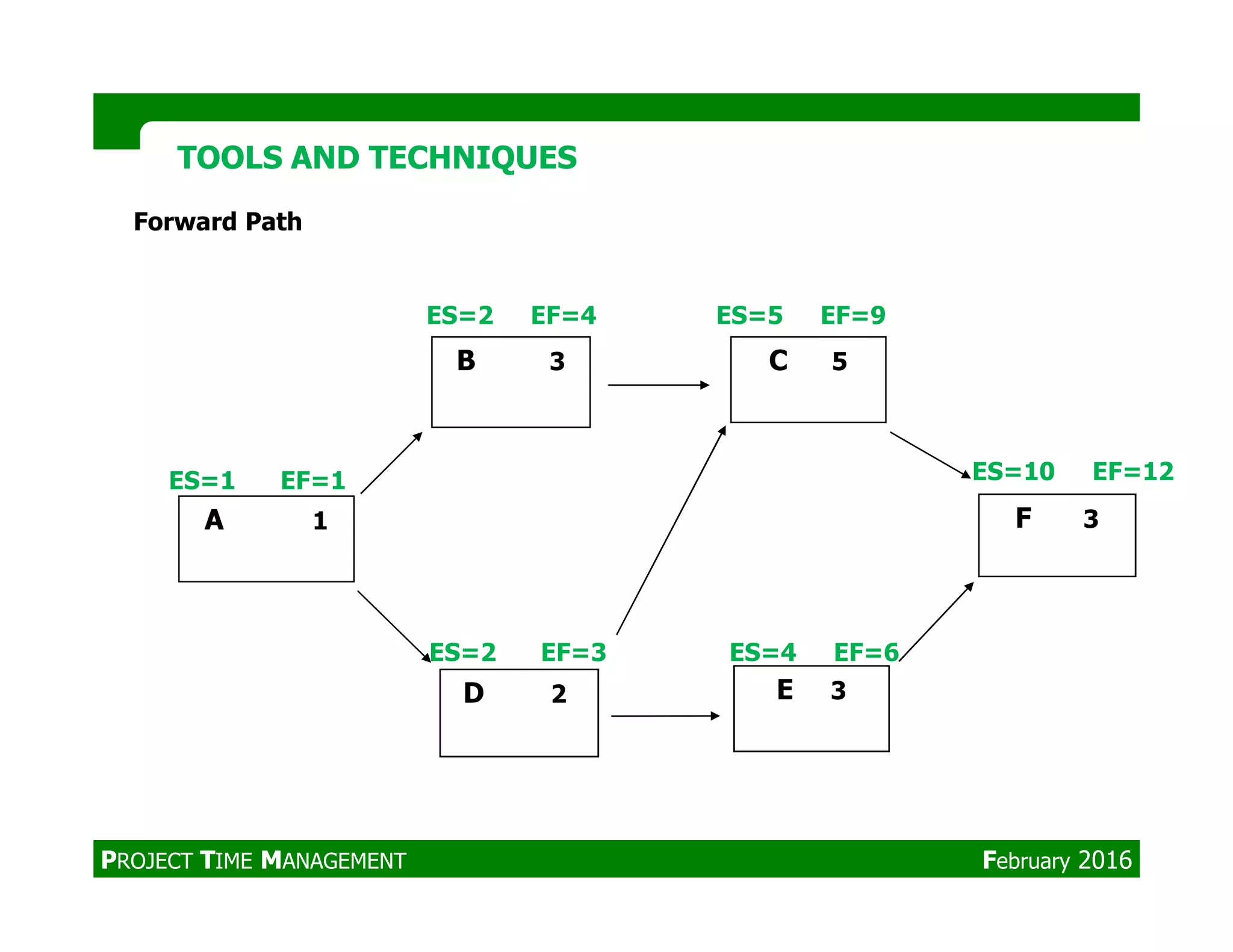

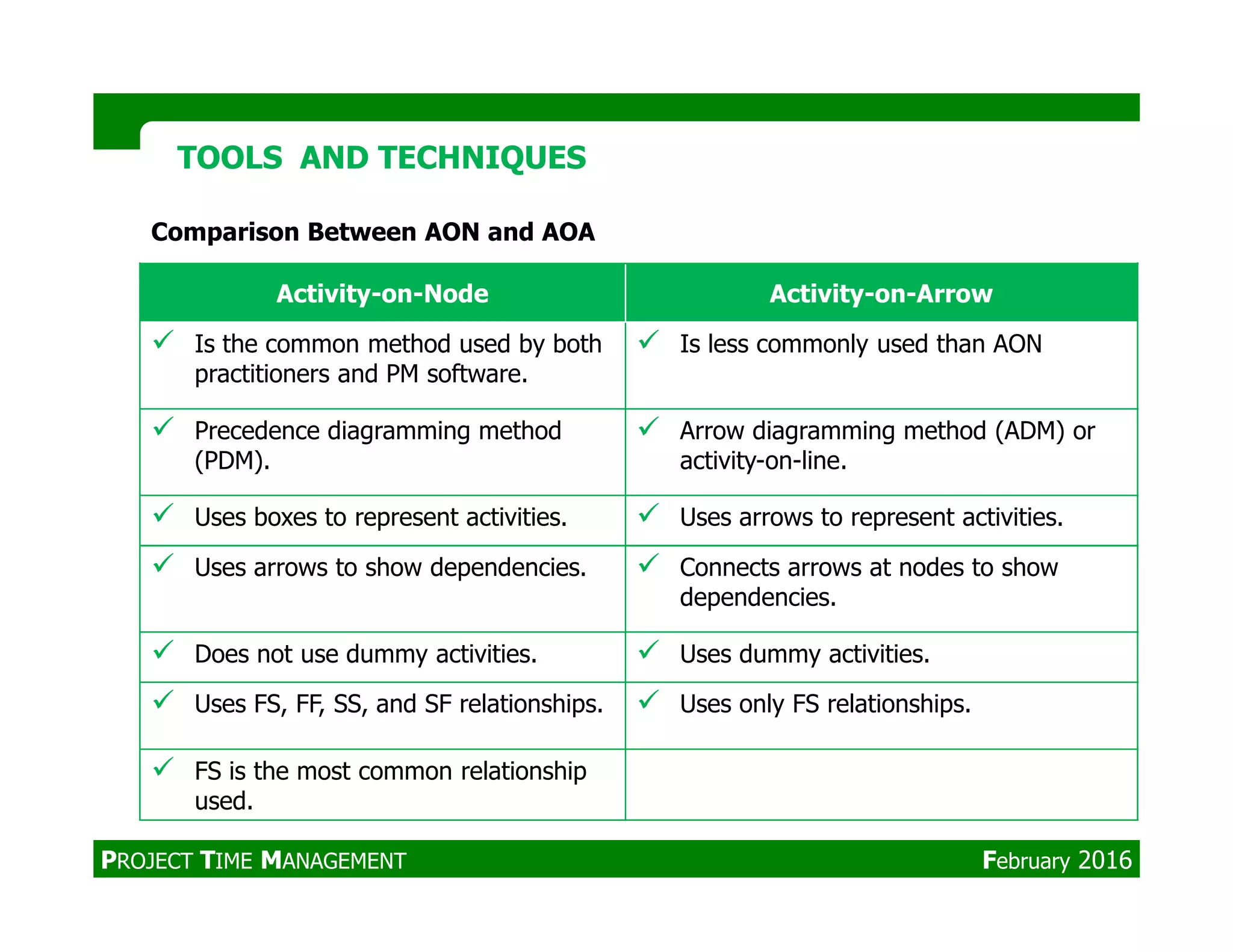

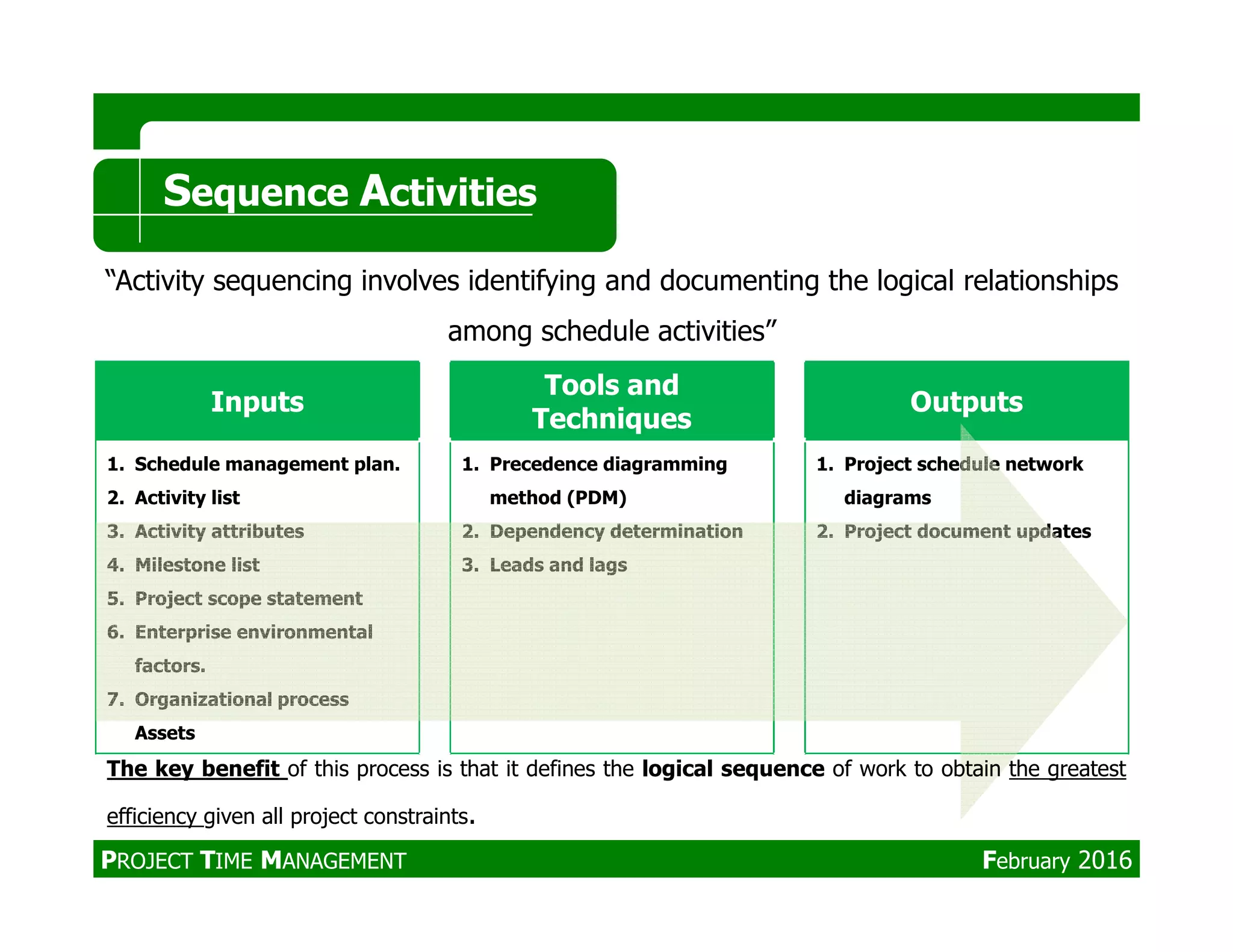

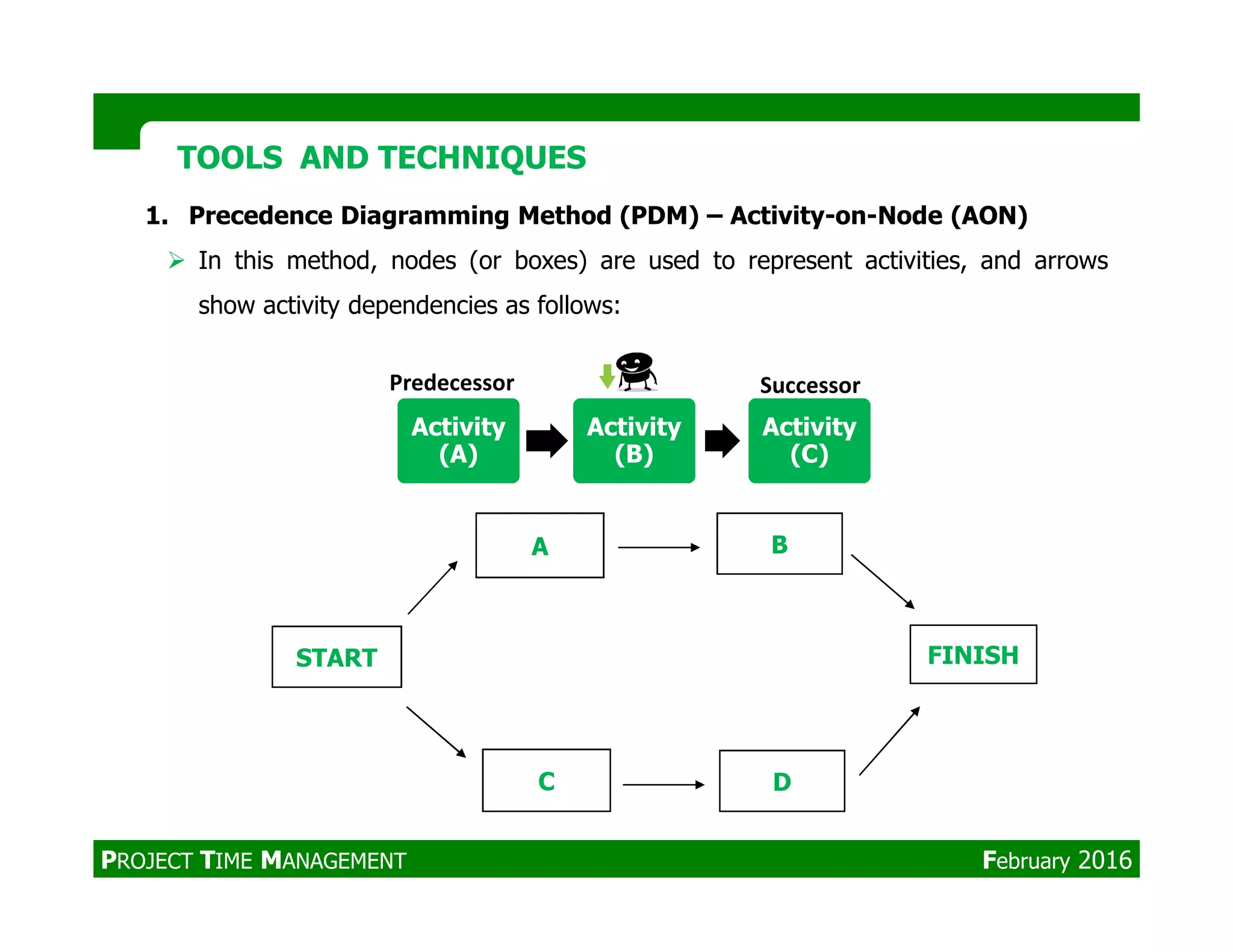

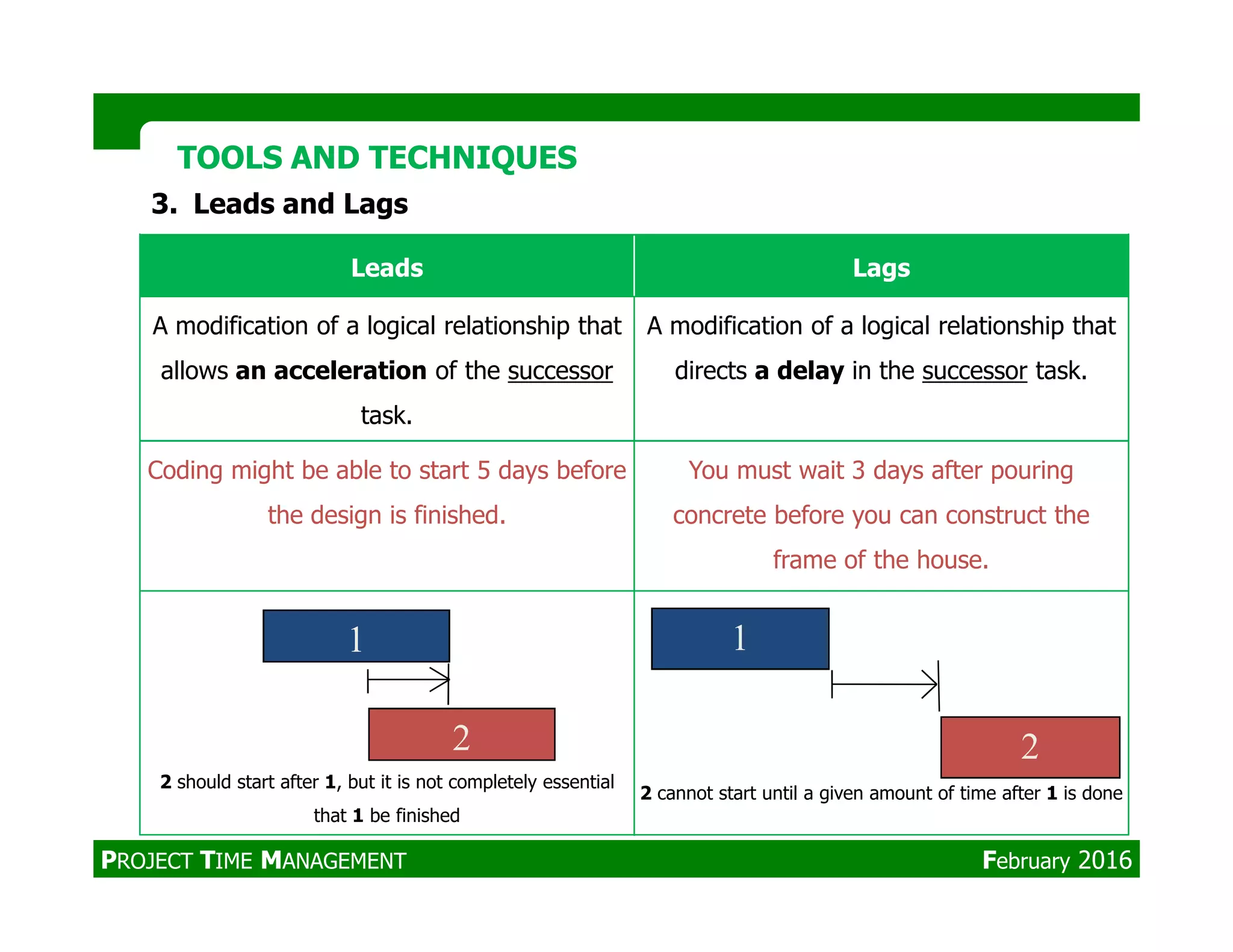

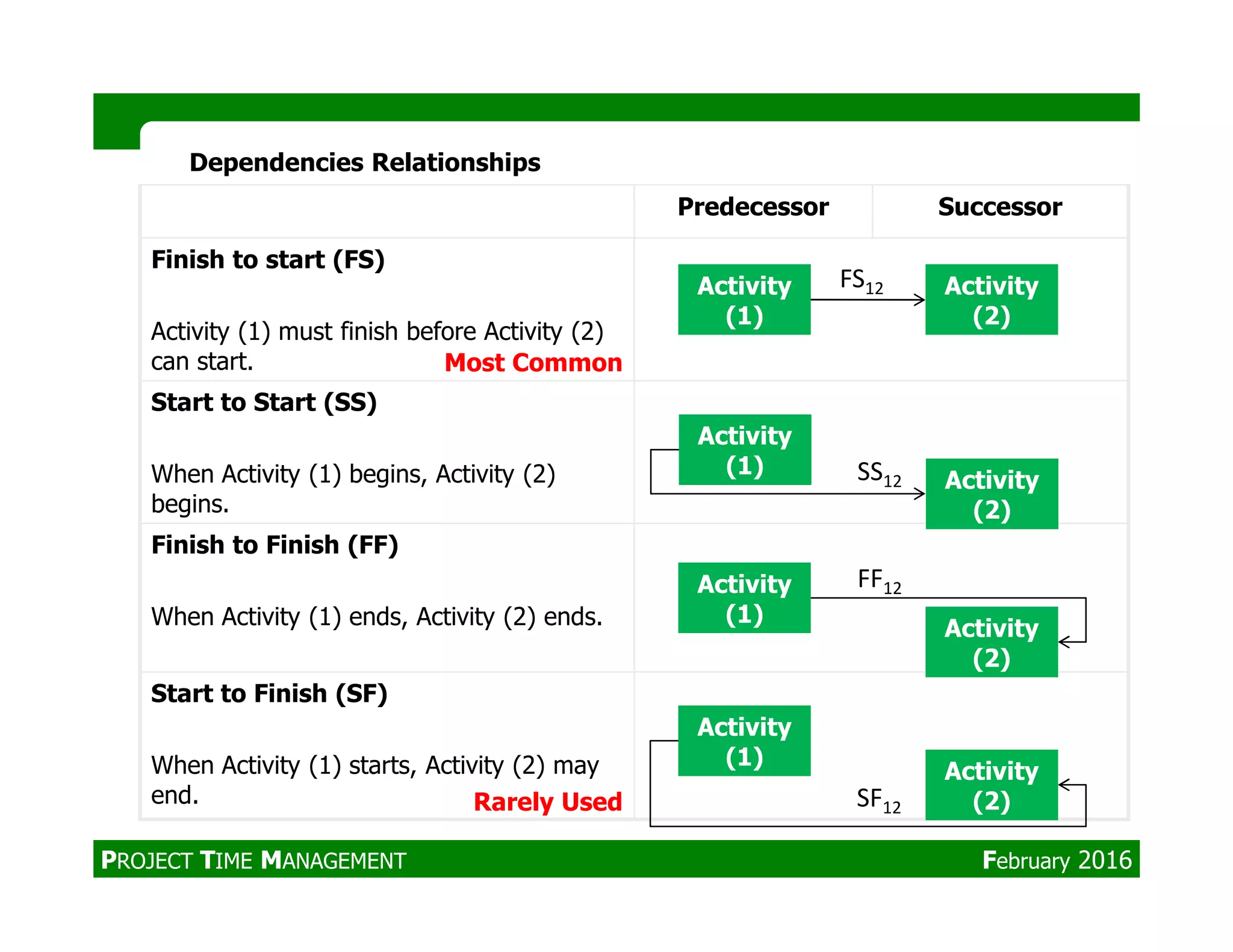

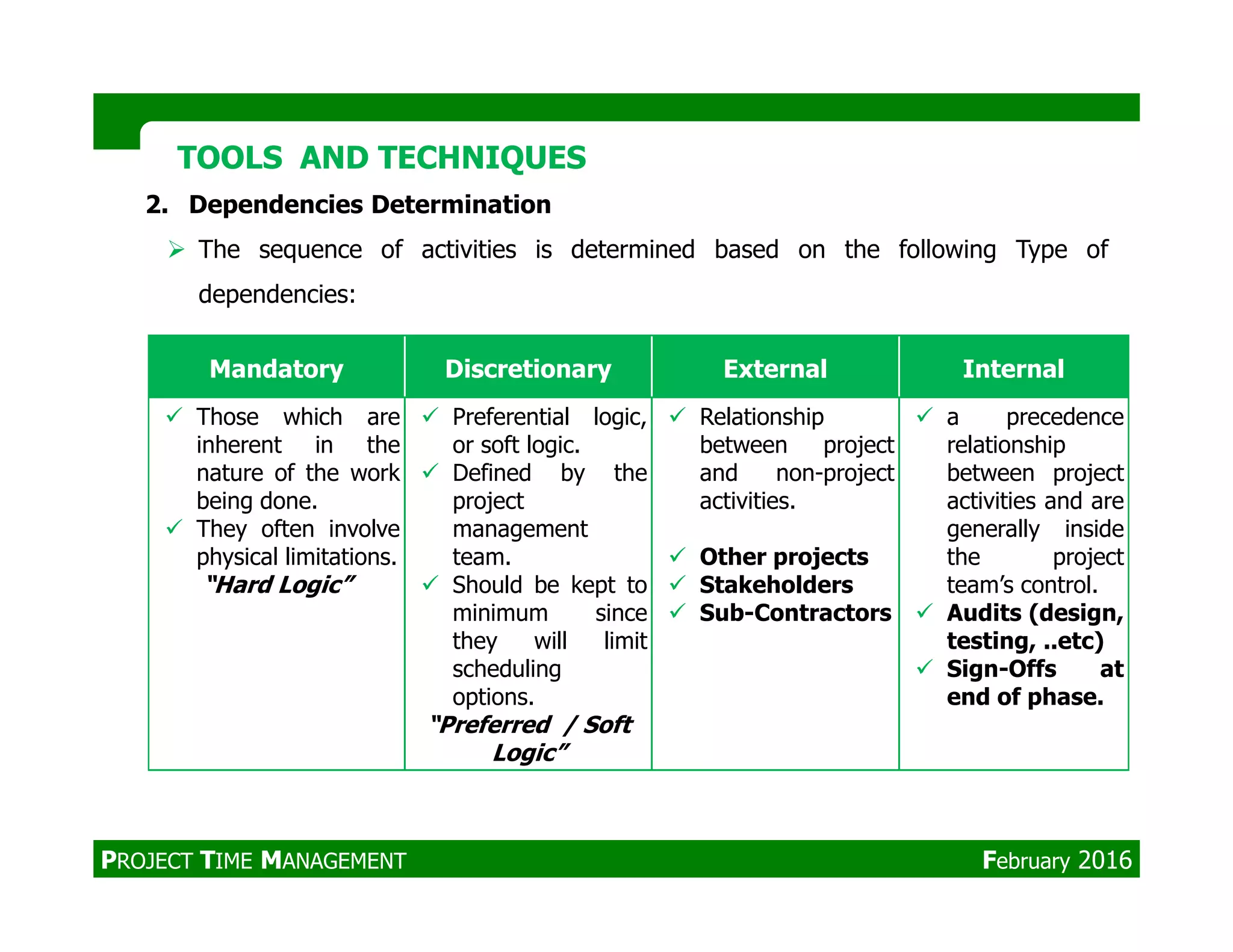

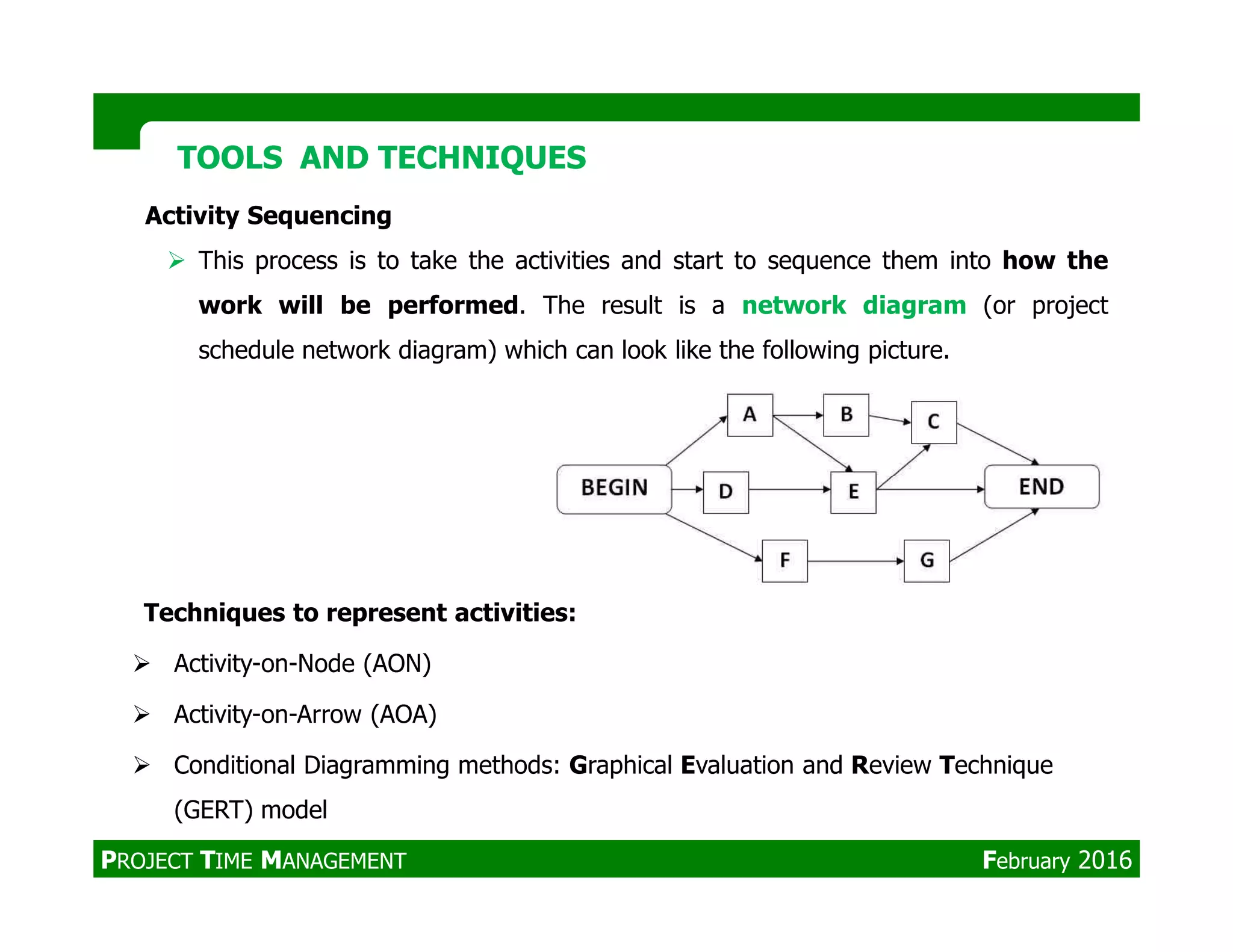

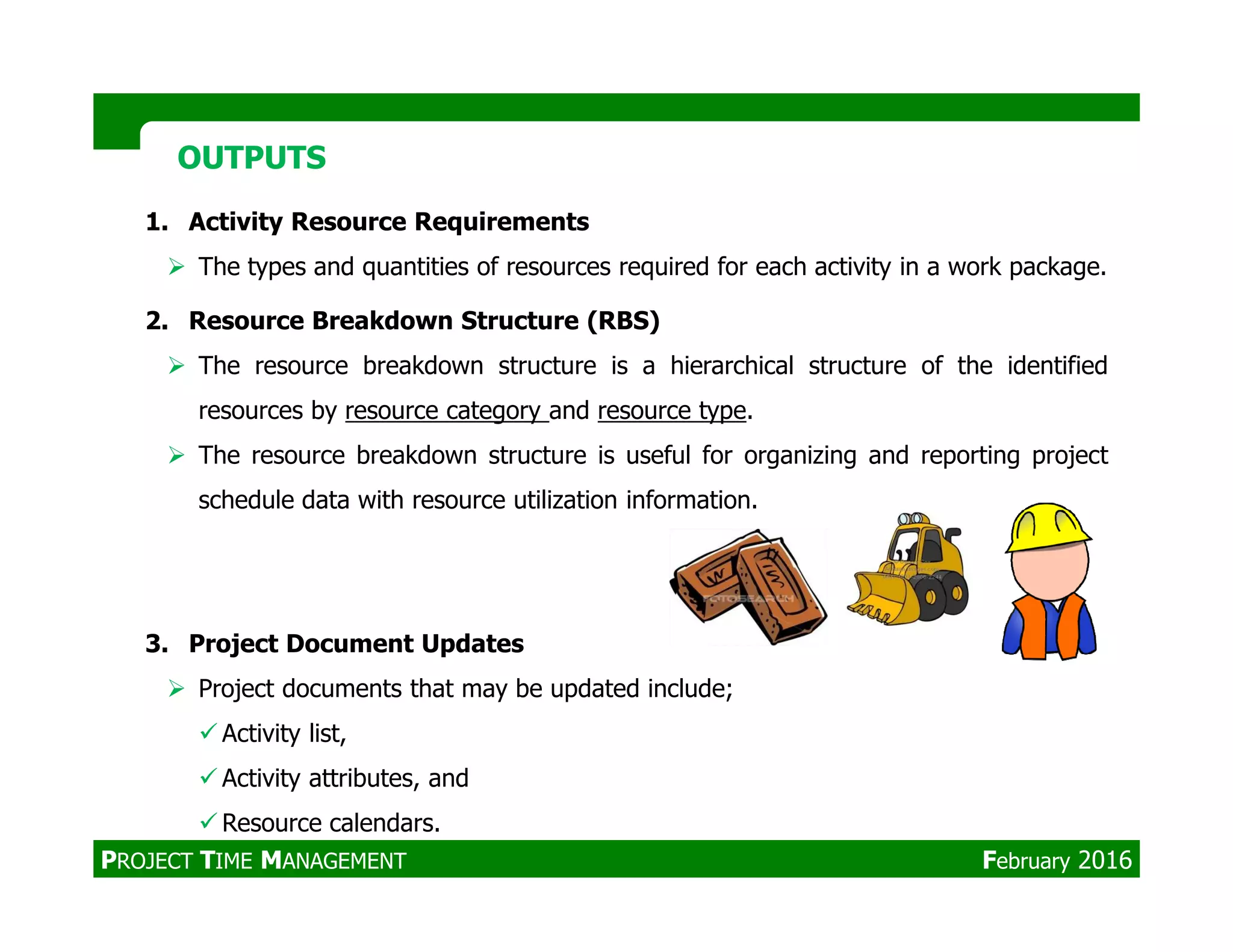

- Sequence activities by identifying logical relationships between activities using techniques like precedence diagramming to develop a project schedule network.

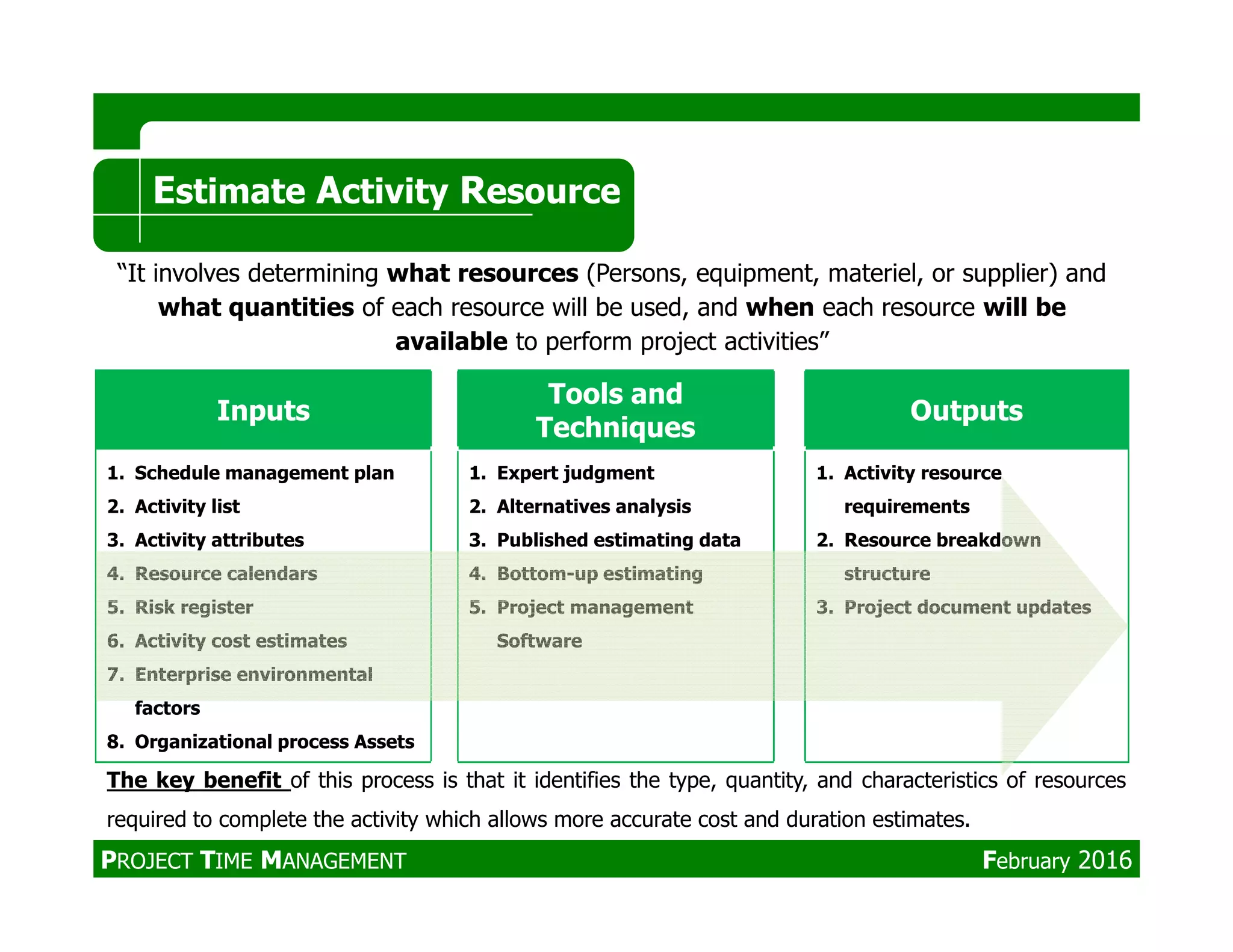

- Estimate activity resources by determining what resources are needed, quantities, and availability to perform each activity. This allows more accurate cost and duration estimates.
