PMP & CAPM
Exam Preparation
  February 19, 2013

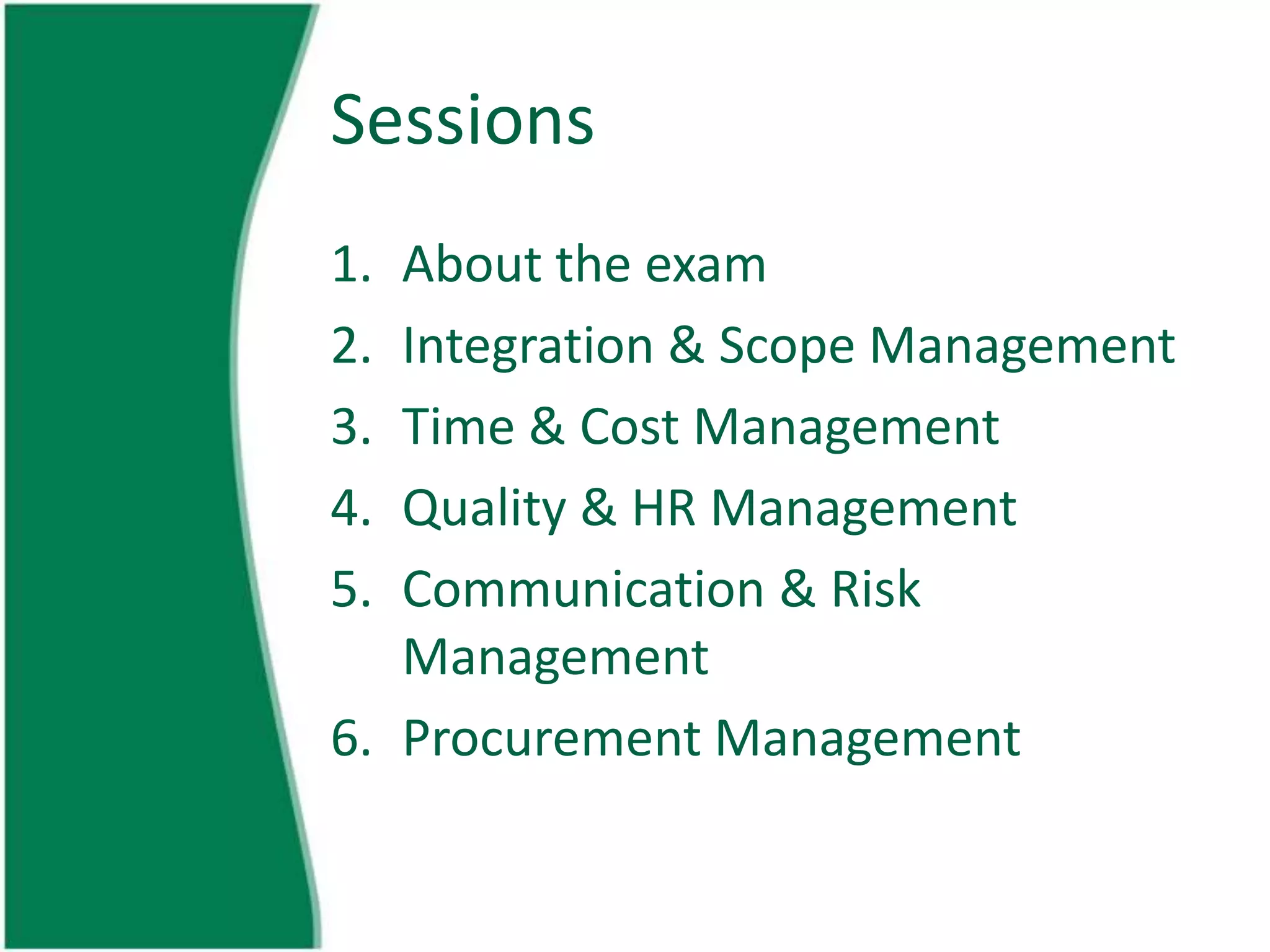

Sessions
1. About the exam
2. Integration & Scope Management
3. Time & Cost Management
4. Quality & HR Management
5. Communication & Risk
   Management
6. Procurement Management

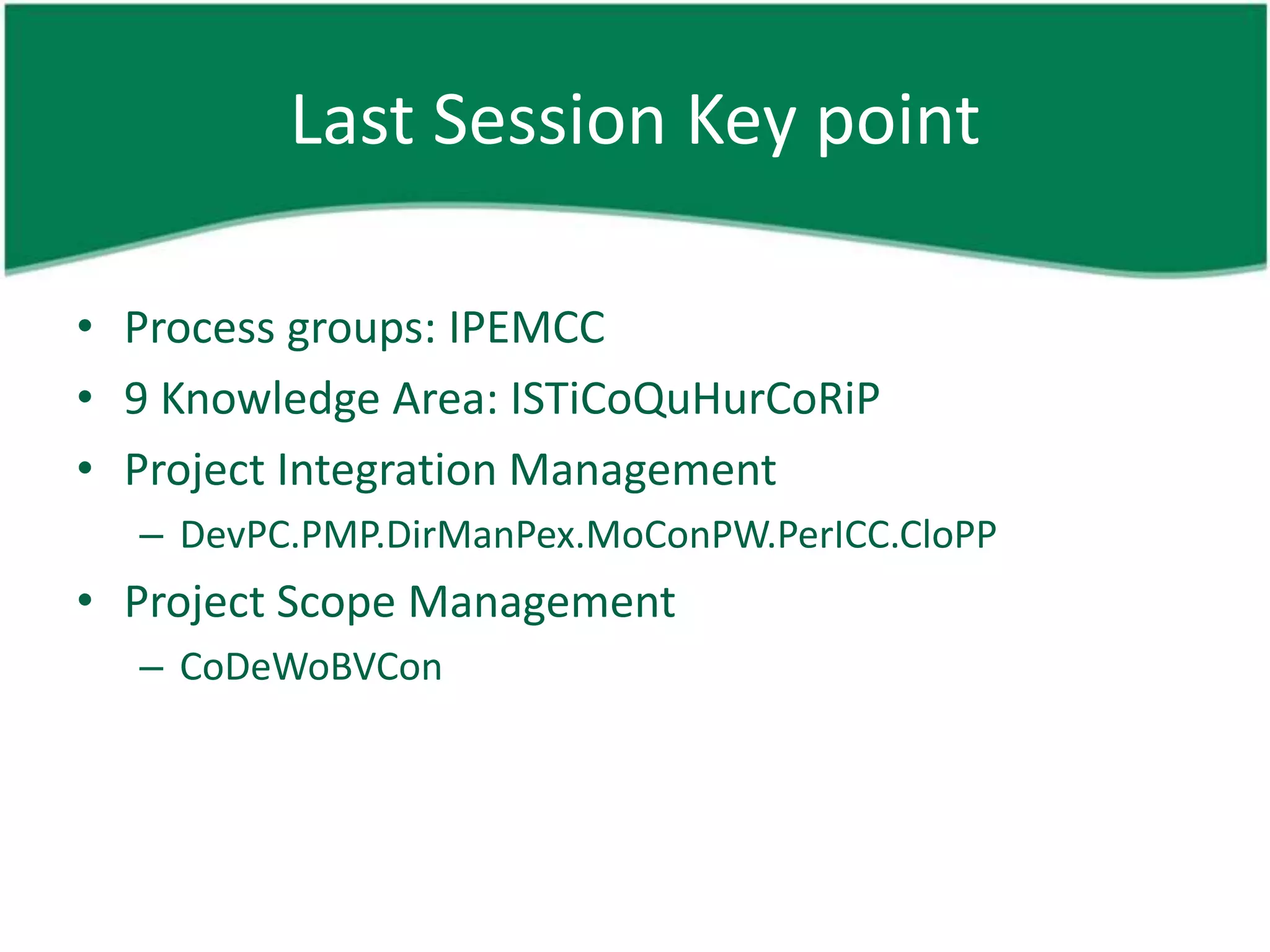

Last Session Key point

• Process groups: IPEMCC
• 9 Knowledge Area: ISTiCoQuHurCoRiP
• Project Integration Management
  – DevPC.PMP.DirManPex.MoConPW.PerICC.CloPP
• Project Scope Management
  – CoDeWoBVCon
Last Session Key point – cont’d

• Project Time Management (DeSeReDDevCon)
   – Define activities
   – Sequence activities
   – Estimate activity resources
   – Estimate activity durations
   – Develop schedule
   – Control schedule
Last Session Key point – cont’d

• Project Cost Management (EsCDeBCon)
   – Estimate cost
   – Determine budget
   – Control cost
Project Quality Management

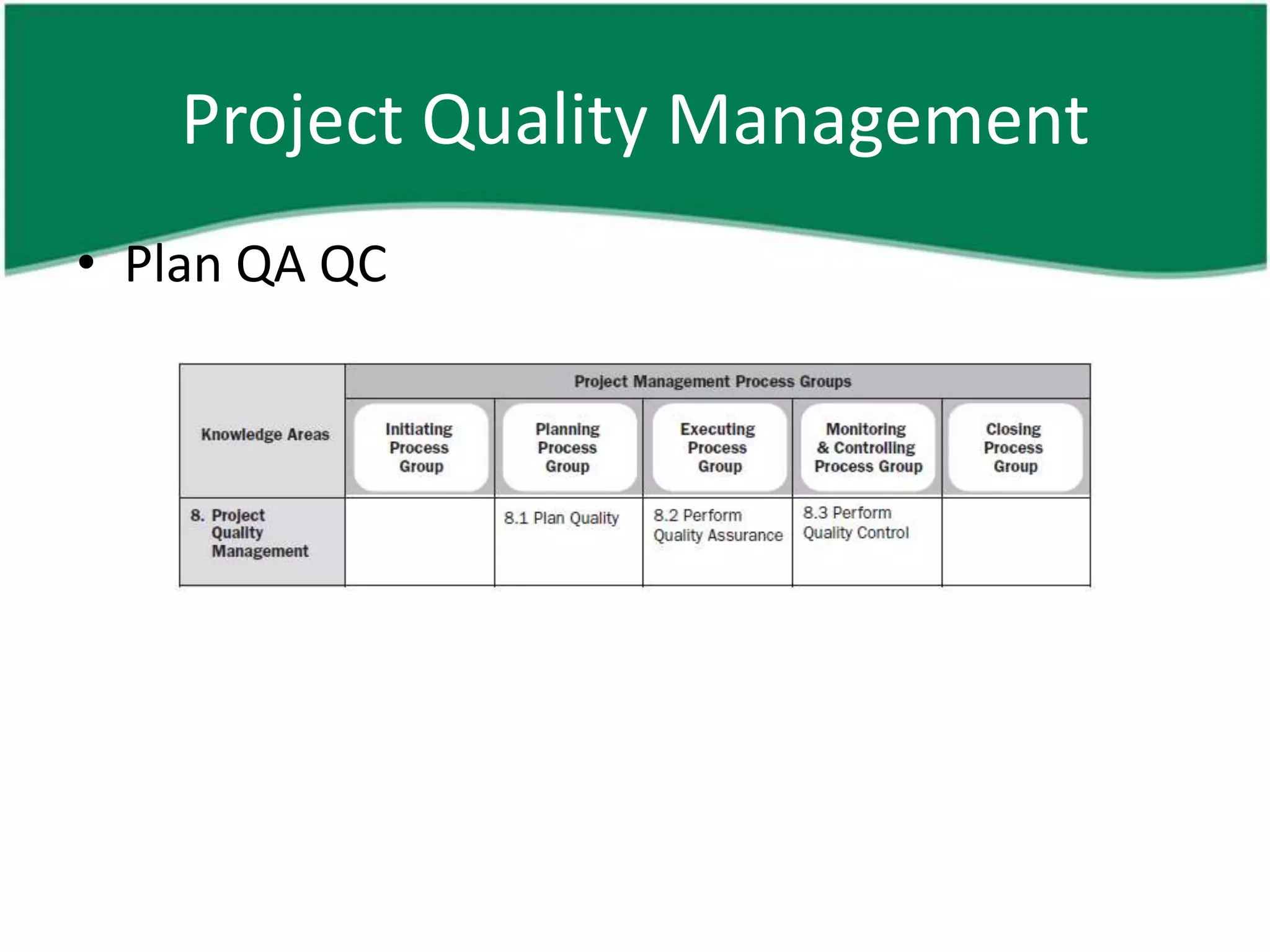

• Plan QA QC
Project Quality Management

• Quality: the degree to which product
  characteristics fulfill requirements
  – Low quality: lots of bugs / defects
• Grade: assigned category to products with
  same/similar functional use but different in
  technical characteristics
  – Low grade: limited features
• Low quality = PROBLEM
Project Quality Management
• Precision: values of repeated measurements
  have little scatter
• Accuracy: measured values closed to true
  value
• Quality management approaches by:
  – Deming, Juan, Crosby
  – TQM, Six Sigma, VoC, FMEA (failure mode and
    effect analysis)
  – Cost of Quality: total cost of all efforts related to
    quality throughout product lifecycle
Project Quality Management

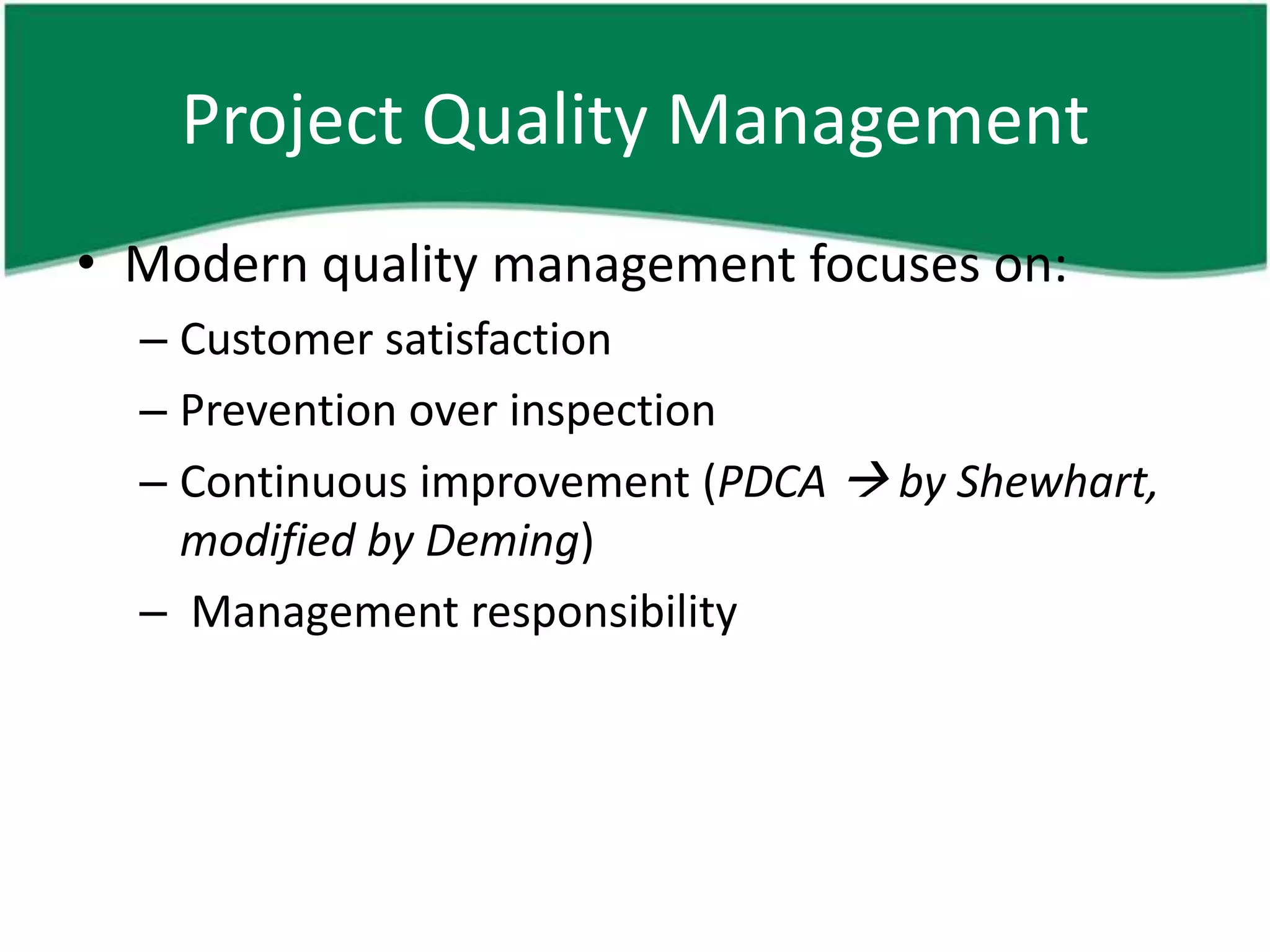

• Modern quality management focuses on:
  – Customer satisfaction
  – Prevention over inspection
  – Continuous improvement (PDCA  by Shewhart,
    modified by Deming)
  – Management responsibility
Project Quality Management

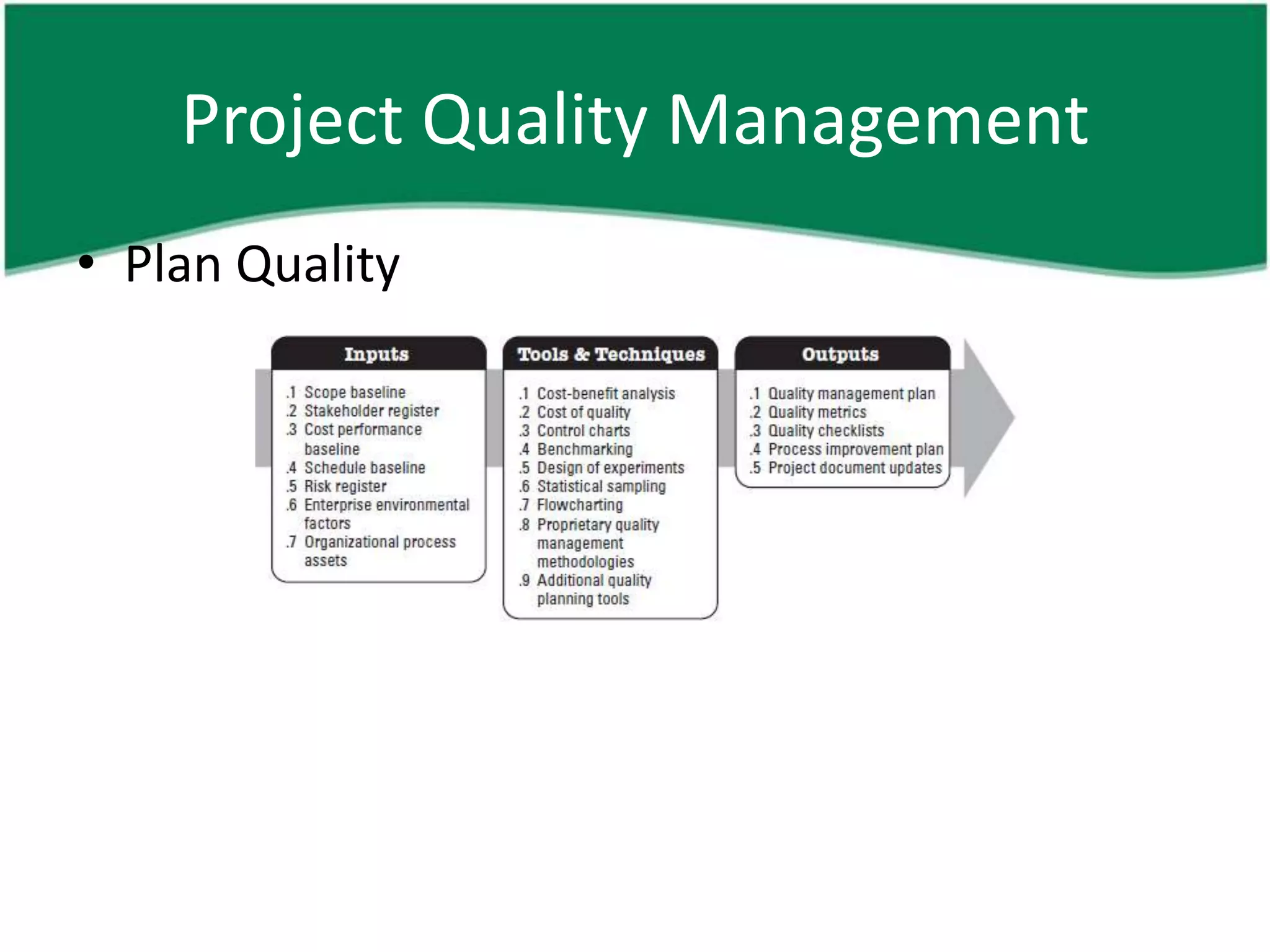

• Plan Quality
Project Quality Management

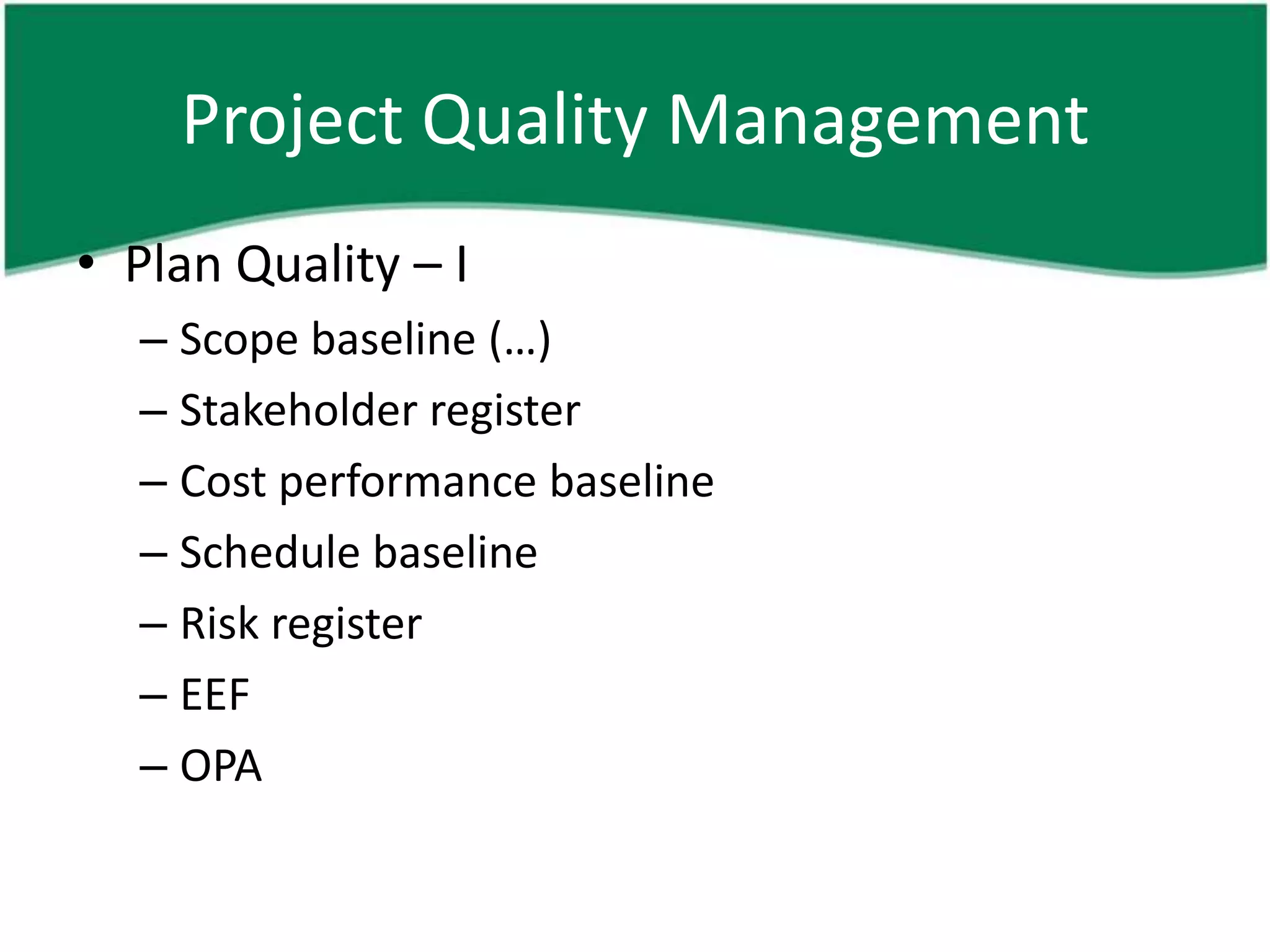

• Plan Quality – I
  – Scope baseline (…)
  – Stakeholder register
  – Cost performance baseline
  – Schedule baseline
  – Risk register
  – EEF
  – OPA
Project Quality Management

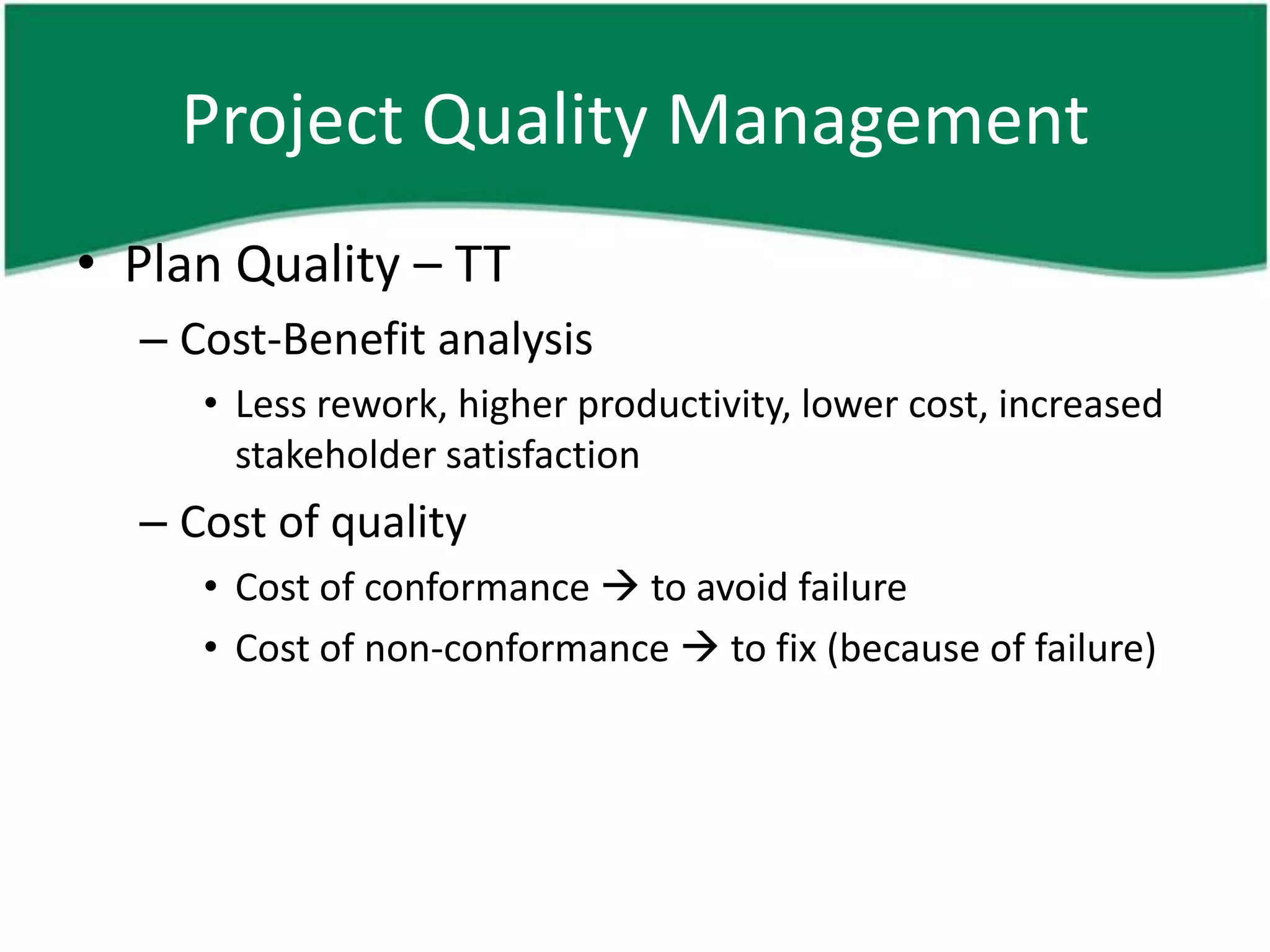

• Plan Quality – TT
  – Cost-Benefit analysis
     • Less rework, higher productivity, lower cost, increased
       stakeholder satisfaction
  – Cost of quality
     • Cost of conformance  to avoid failure
     • Cost of non-conformance  to fix (because of failure)
Project Quality Management

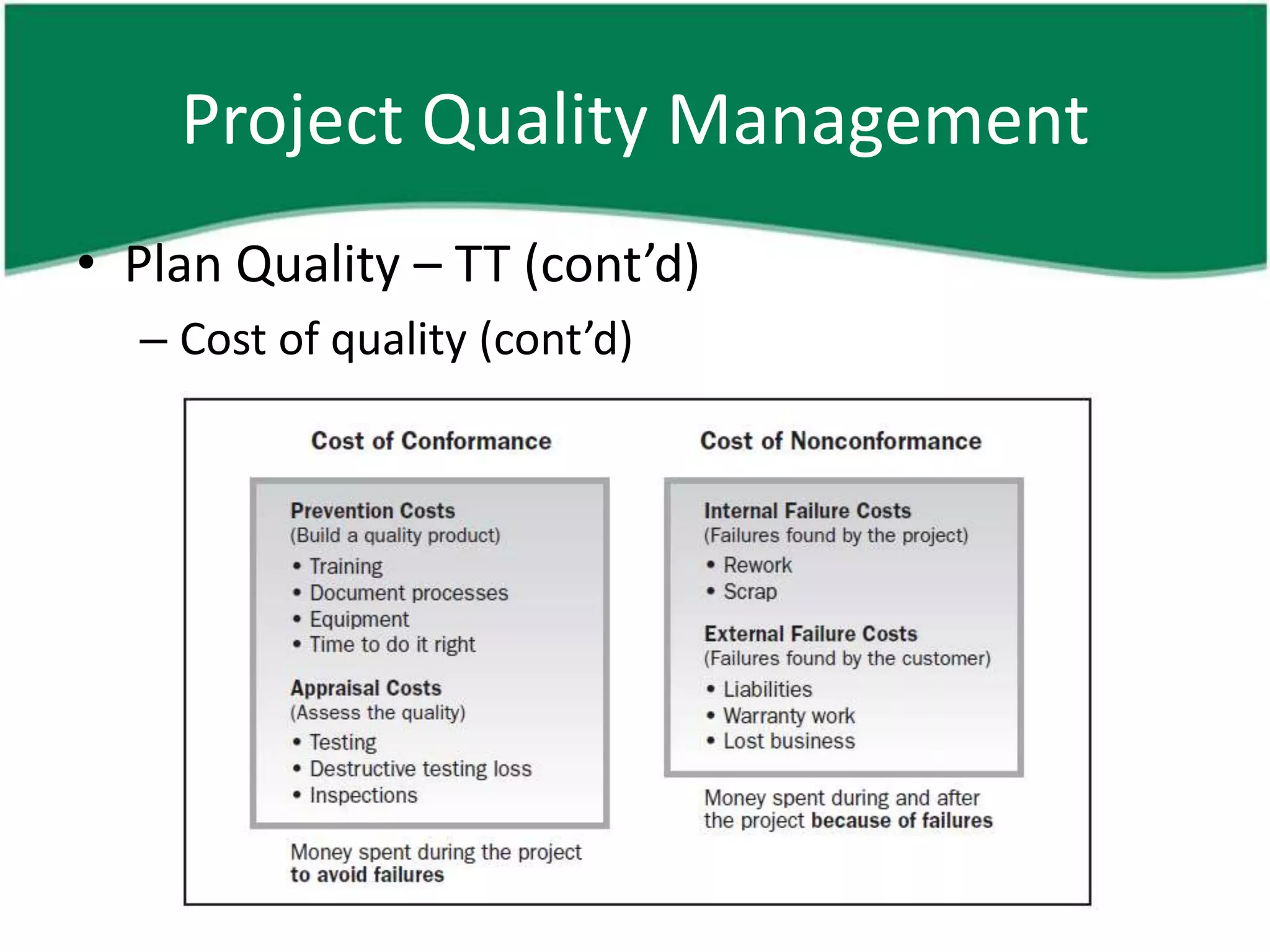

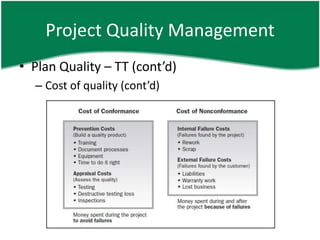

• Plan Quality – TT (cont’d)
  – Cost of quality (cont’d)
Project Quality Management

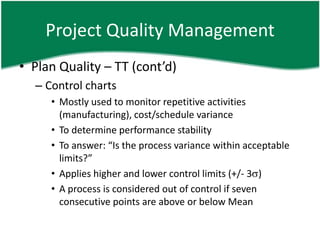

• Plan Quality – TT (cont’d)

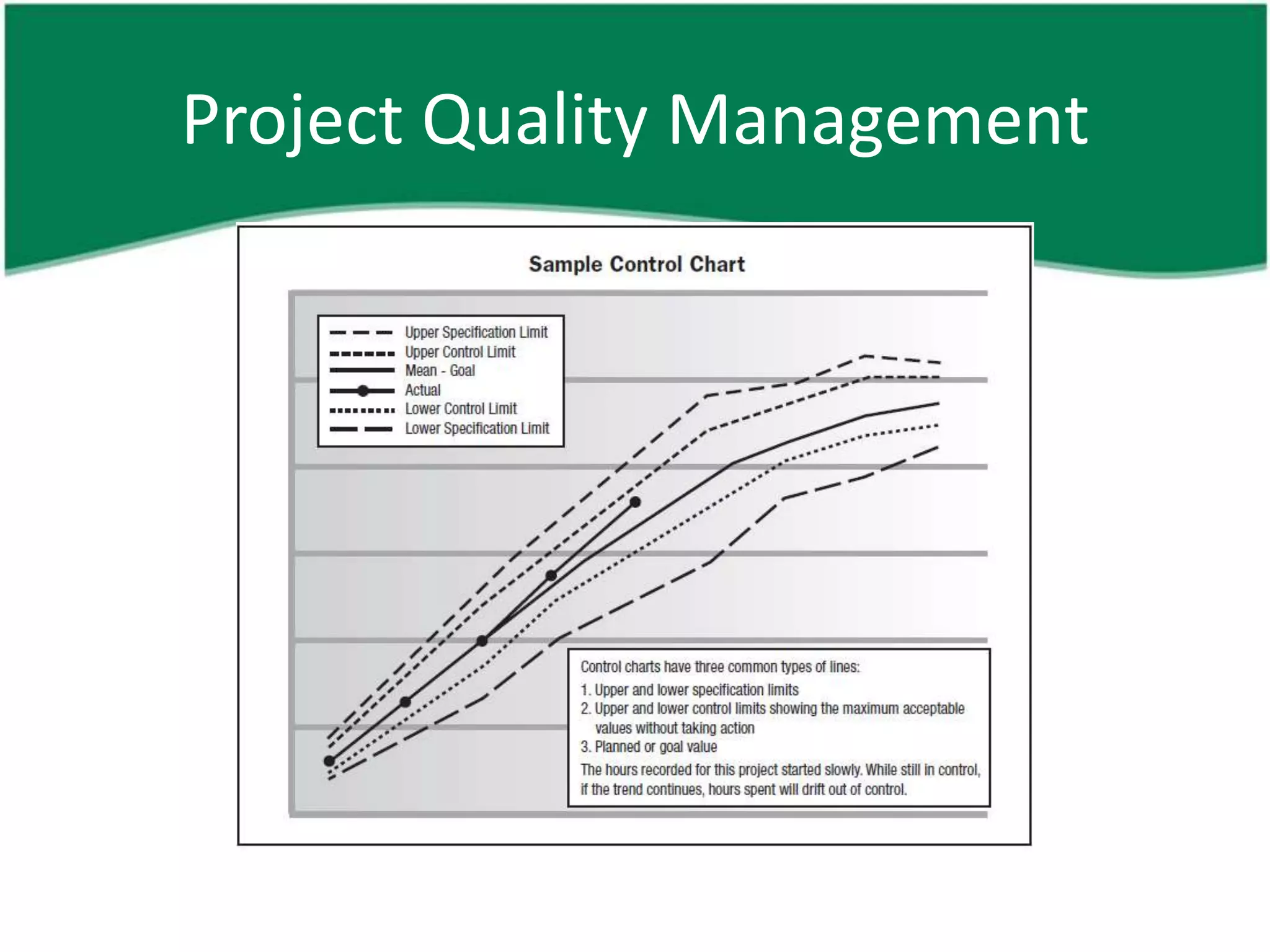

  – Control charts
     • Mostly used to monitor repetitive activities
       (manufacturing), cost/schedule variance
     • To determine performance stability
     • To answer: “Is the process variance within acceptable
       limits?”
     • Applies higher and lower control limits (+/- 3 )
     • A process is considered out of control if seven
       consecutive points are above or below Mean

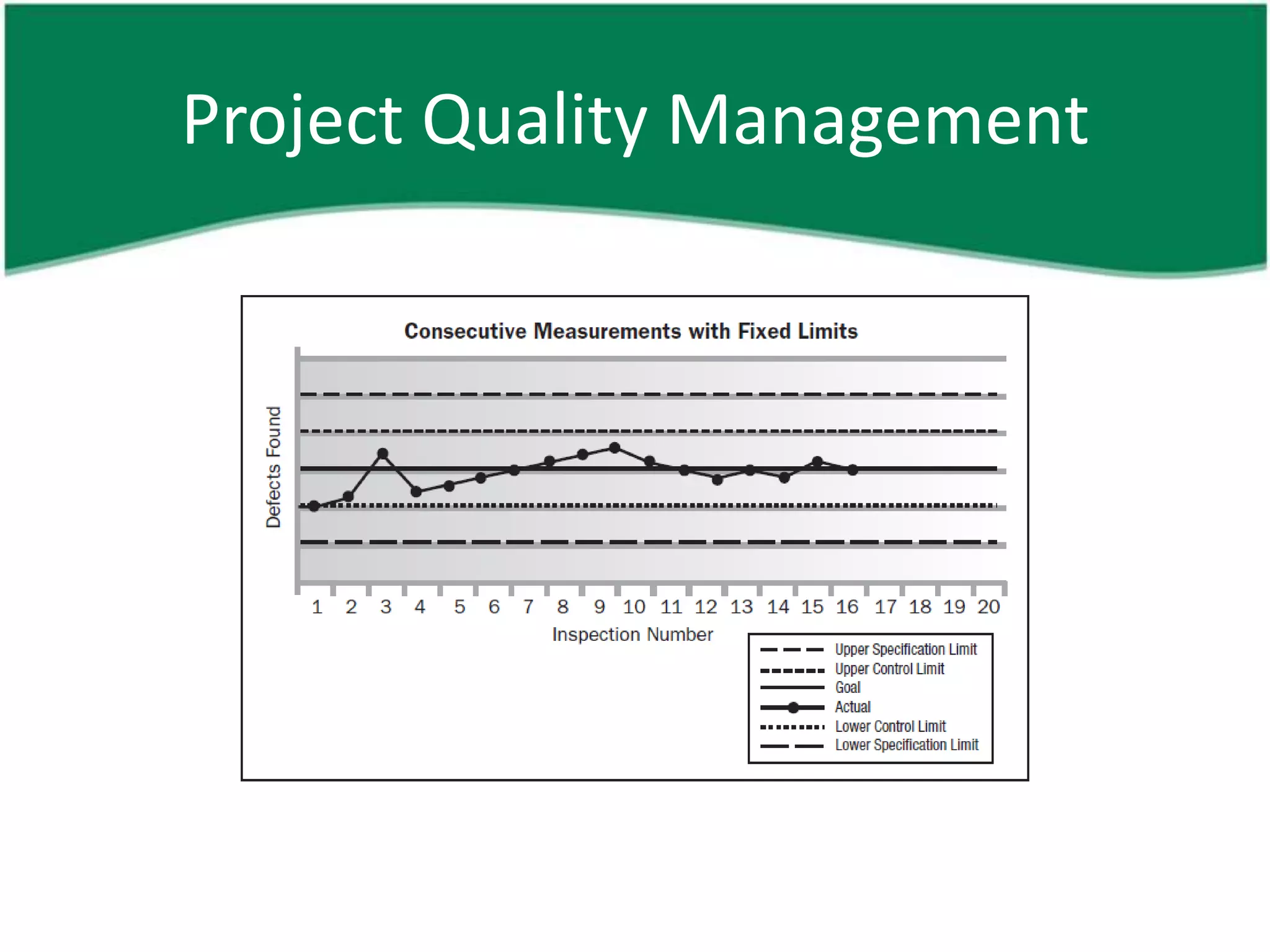

Project Quality Management
Project Quality Management
Project Quality Management
• Plan Quality – TT (cont’d)
  – Benchmarking (comparison)
  – Design of Experiments
     • Statistical method to identify factors influencing
       product’s variables
     • Can be used to determine number and type of tests,
       and impact of cost of quality
     • E.g.: experiment to combine chemical materials to
       produce strong adhesive material
Project Quality Management

• Plan Quality – TT (cont’d)
  – Statistical sampling
  – Flowcharting
Project Quality Management
• Plan Quality – TT (cont’d)
  – Proprietary quality management methodologies
     •   Six sigma
     •   Lean six sigma
     •   Quality function deployment
     •   etc
Project Quality Management

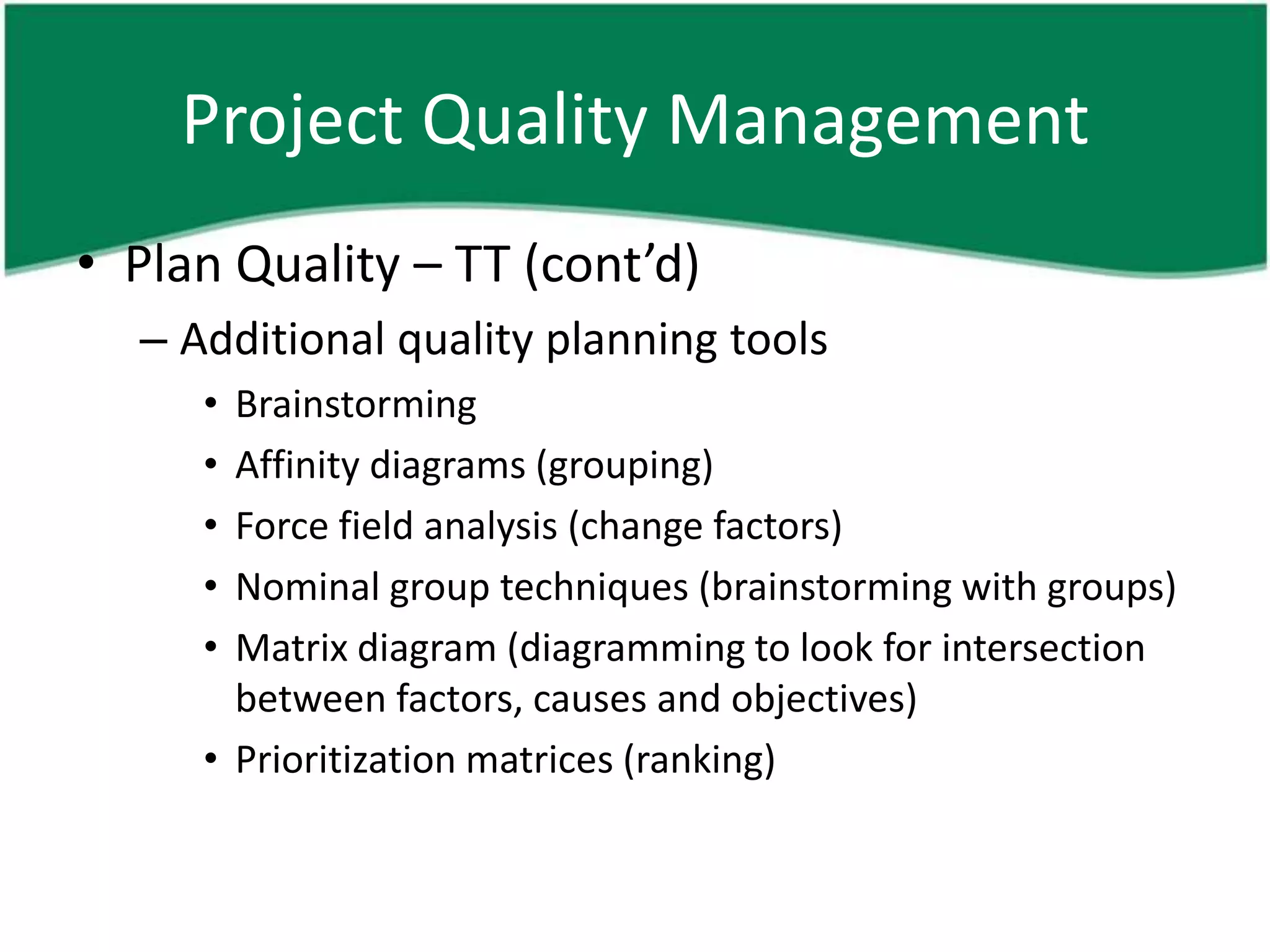

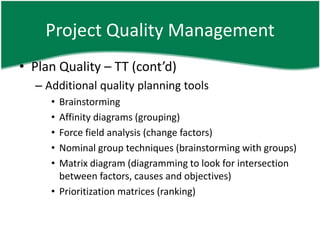

• Plan Quality – TT (cont’d)
  – Additional quality planning tools
     • Brainstorming
     • Affinity diagrams (grouping)
     • Force field analysis (change factors)
     • Nominal group techniques (brainstorming with groups)
     • Matrix diagram (diagramming to look for intersection
       between factors, causes and objectives)
     • Prioritization matrices (ranking)
Project Quality Management

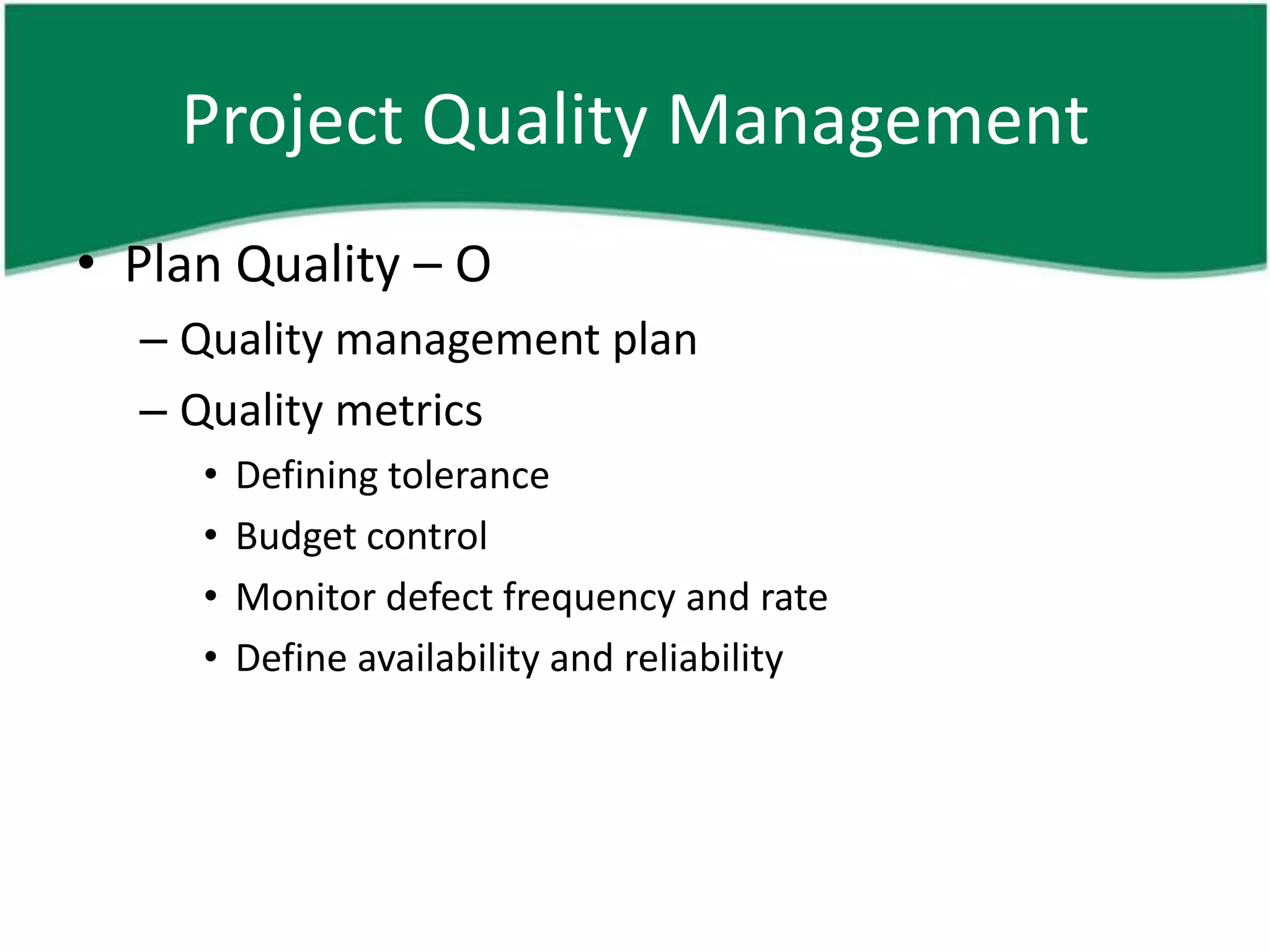

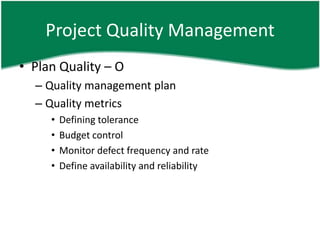

• Plan Quality – O
  – Quality management plan
  – Quality metrics
     •   Defining tolerance
     •   Budget control
     •   Monitor defect frequency and rate
     •   Define availability and reliability
Project Quality Management

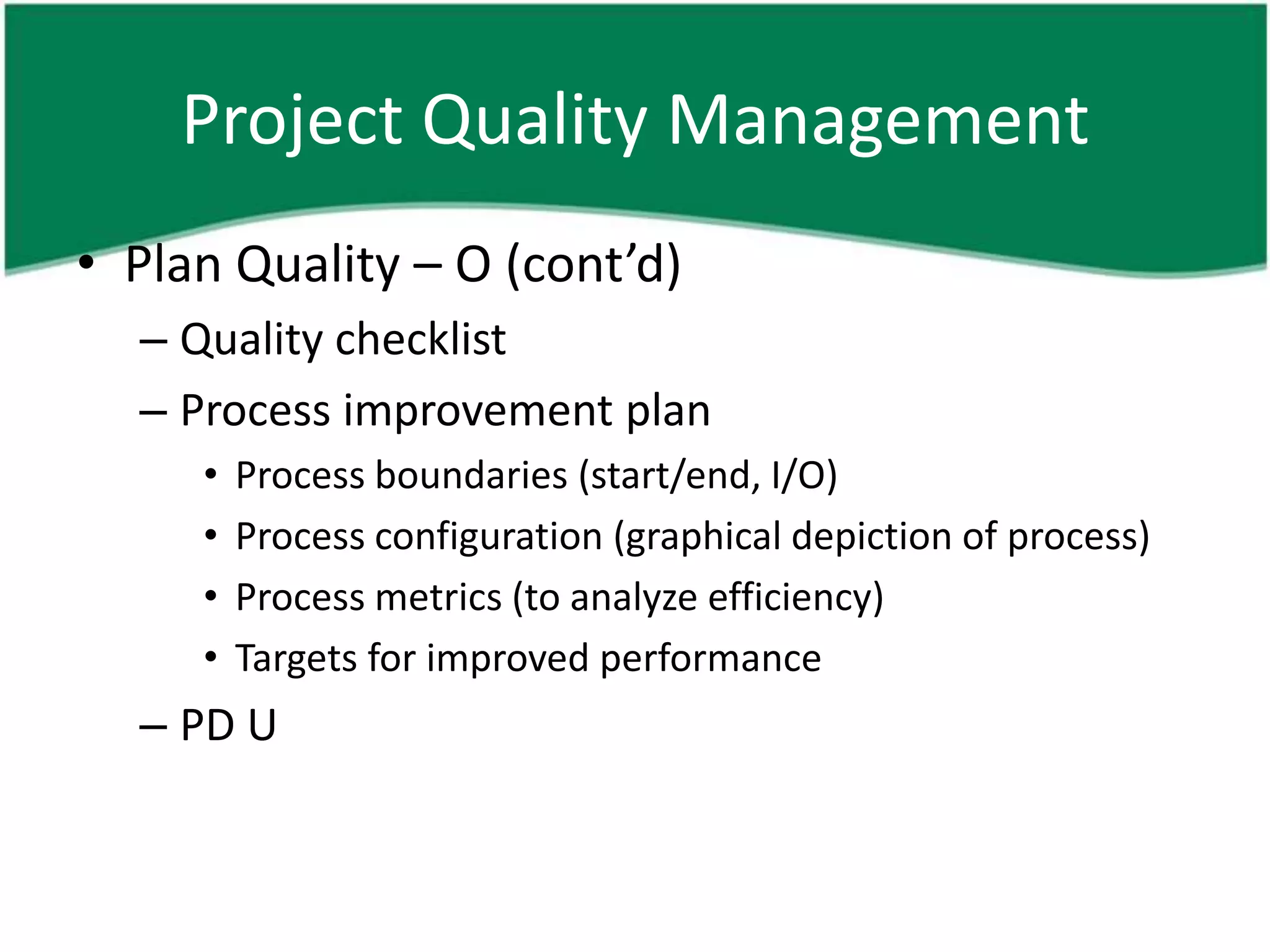

• Plan Quality – O (cont’d)
  – Quality checklist
  – Process improvement plan
     •   Process boundaries (start/end, I/O)
     •   Process configuration (graphical depiction of process)
     •   Process metrics (to analyze efficiency)
     •   Targets for improved performance
  – PD U
Project Quality Management

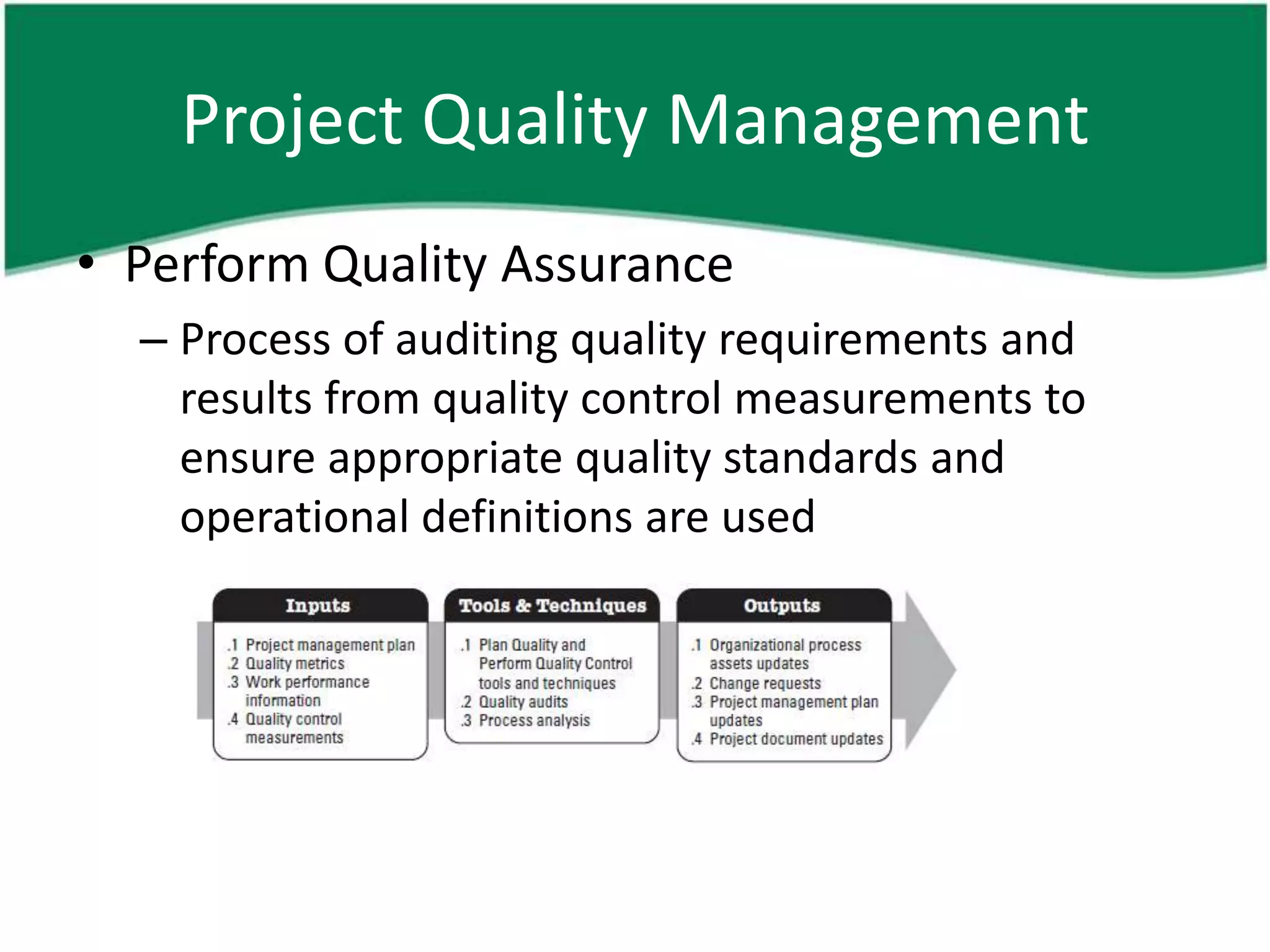

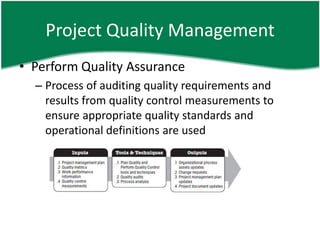

• Perform Quality Assurance
  – Process of auditing quality requirements and
    results from quality control measurements to
    ensure appropriate quality standards and
    operational definitions are used
Project Quality Management
• Perform Quality Assurance – I
  – PMP
  – Quality metrics
  – WPI
  – Quality control measurements
Project Quality Management

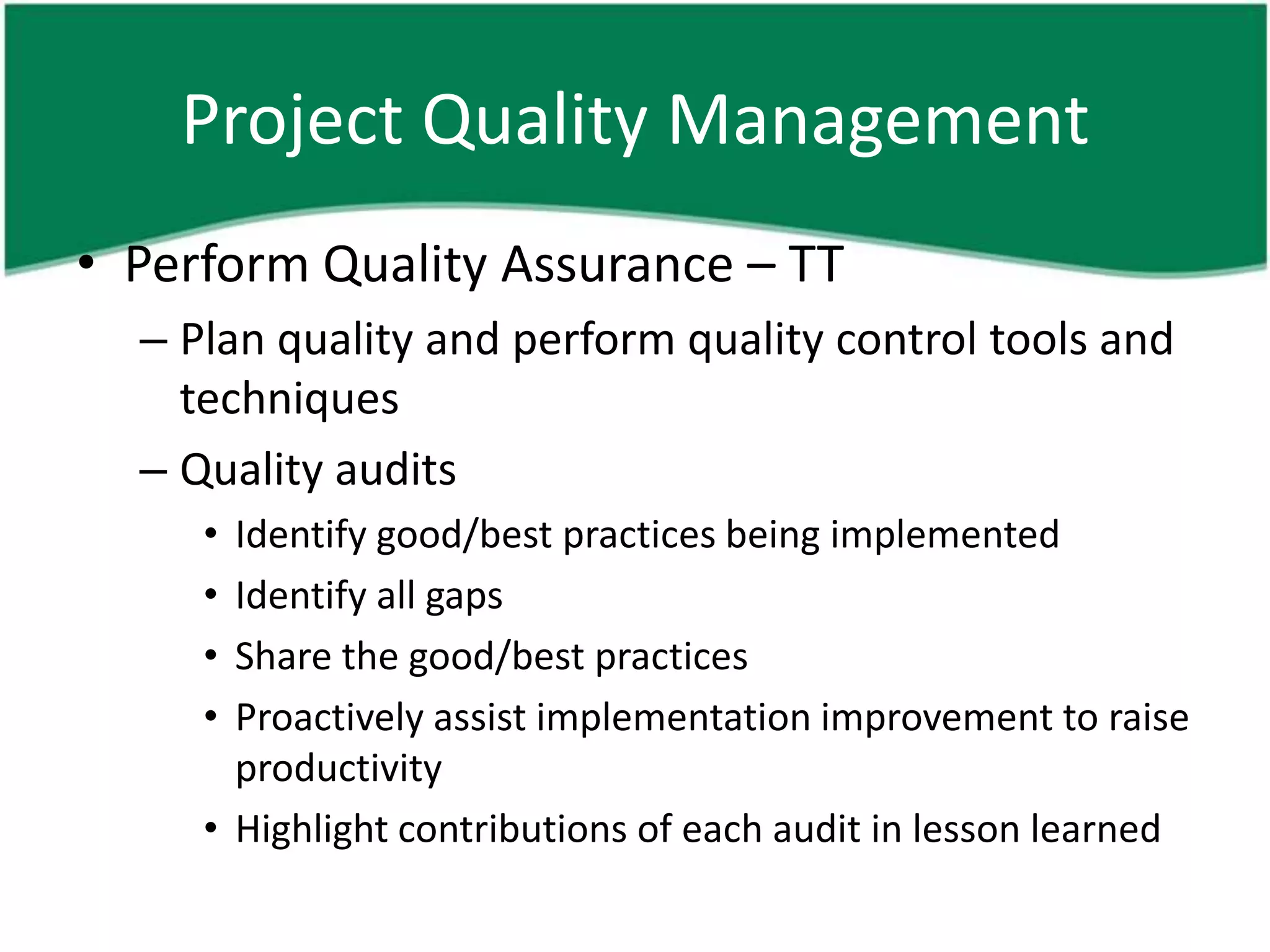

• Perform Quality Assurance – TT
  – Plan quality and perform quality control tools and
    techniques
  – Quality audits
     • Identify good/best practices being implemented
     • Identify all gaps
     • Share the good/best practices
     • Proactively assist implementation improvement to raise
       productivity
     • Highlight contributions of each audit in lesson learned
Project Quality Management
• Perform Quality Assurance – TT (cont’d)
  – Process analysis
     • Identify a problem
     • Discover root cause
     • Develop preventive actions
Project Quality Management

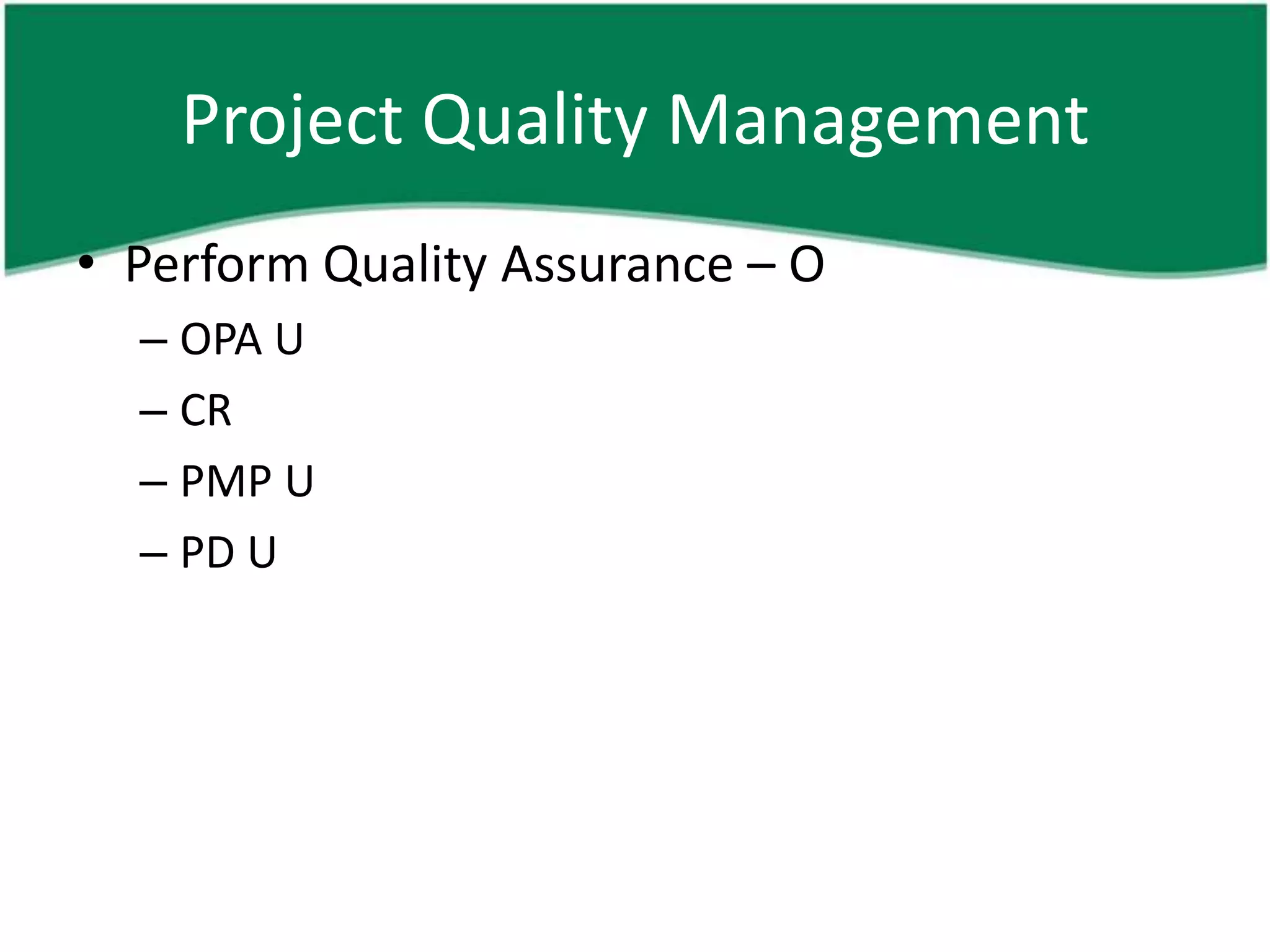

• Perform Quality Assurance – O
  – OPA U
  – CR
  – PMP U
  – PD U
Project Quality Management
• Perform Quality Control
  – Process of monitoring and recording results of
    executing the quality activities to assess
    performance and recommend necessary changes
  – Performed throughout the project
  – The QC team must know the concept of:
     • Prevention and Inspection
     • Attribute sampling and variable sampling
     • Tolerance and control limit
Project Quality Management

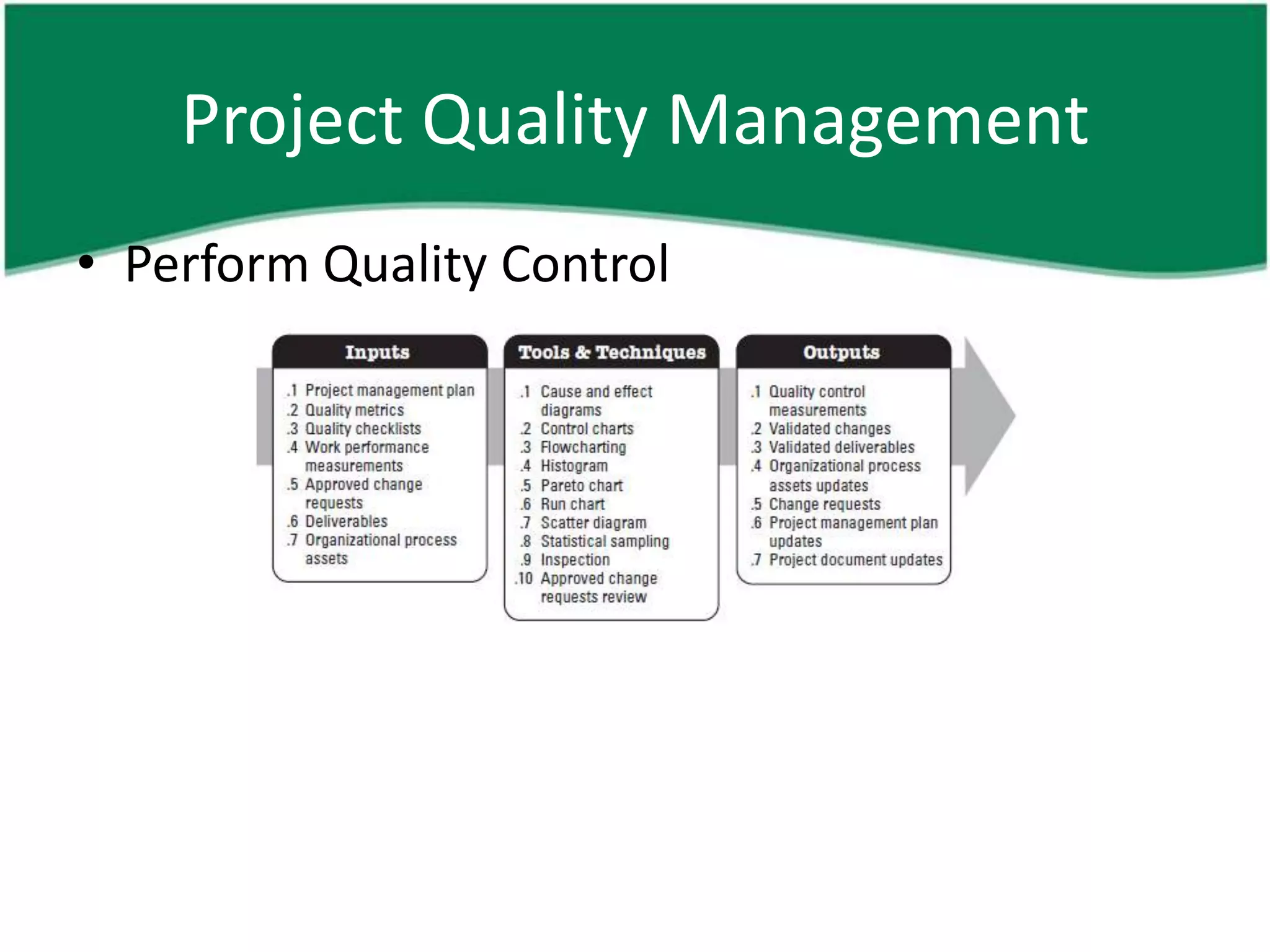

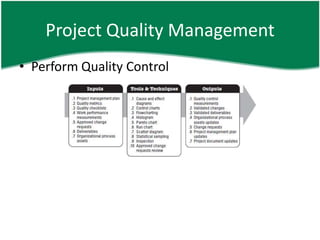

• Perform Quality Control
Project Quality Management

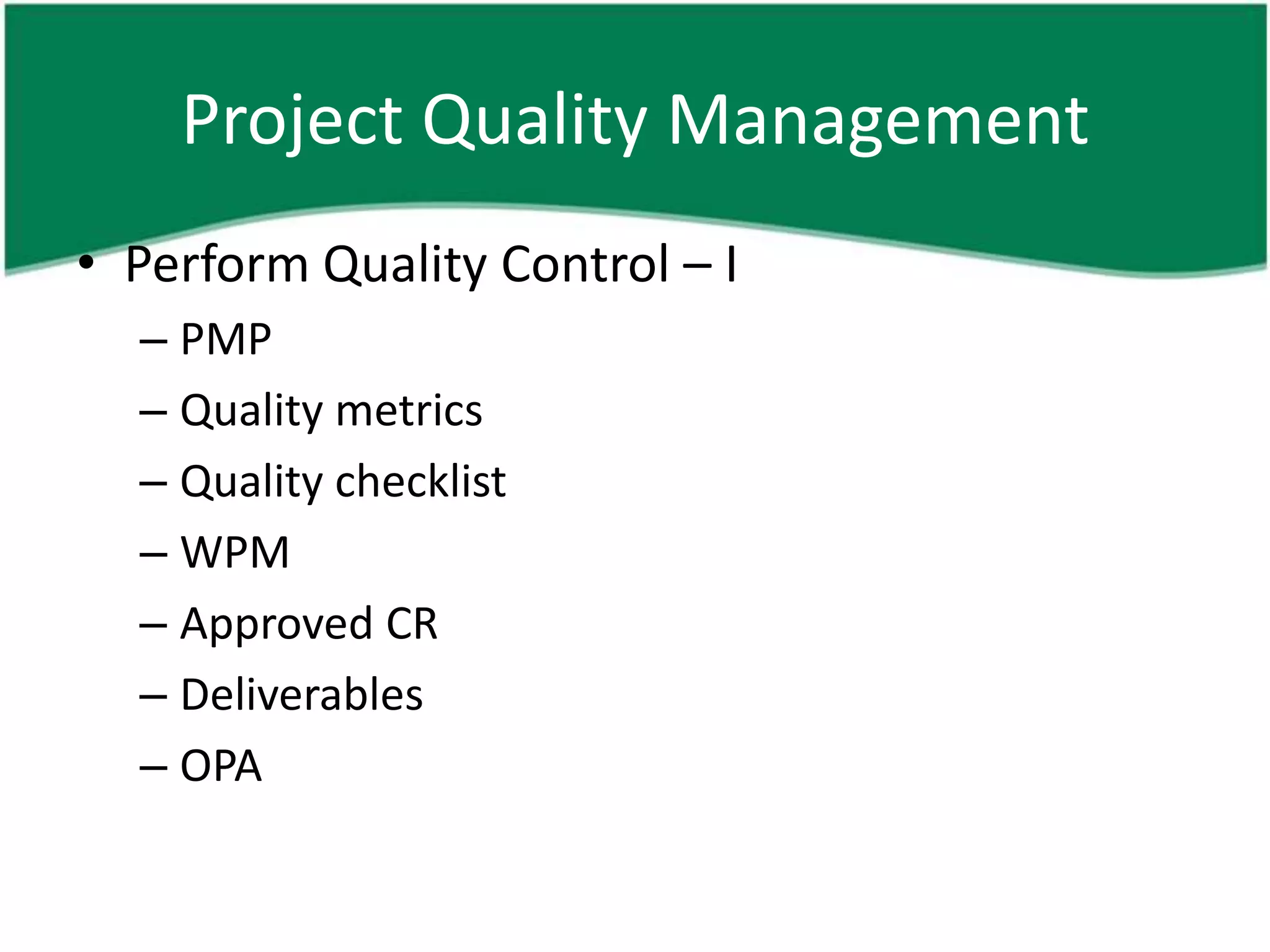

• Perform Quality Control – I
  – PMP
  – Quality metrics
  – Quality checklist
  – WPM
  – Approved CR
  – Deliverables
  – OPA
Project Quality Management
• Perform Quality Control – TT

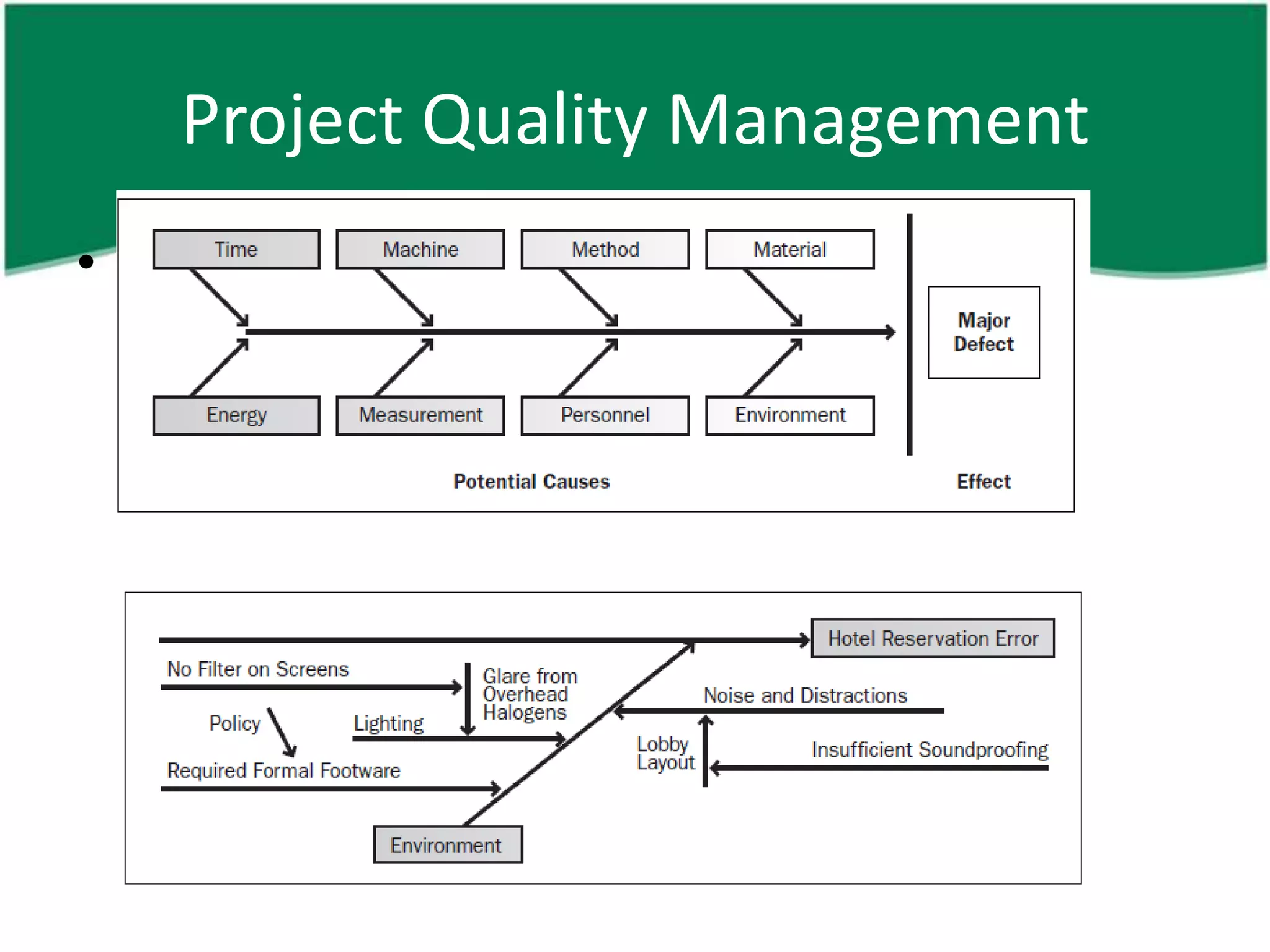

  – Cause and effect diagrams
     • AKA: ishikawa or fishbone diagrams
     • Asking: Why or How  Why why and How how
Project Quality Management
• Perform Quality Control – TT (cont’d)
  – Control charts
  – Flowcharting

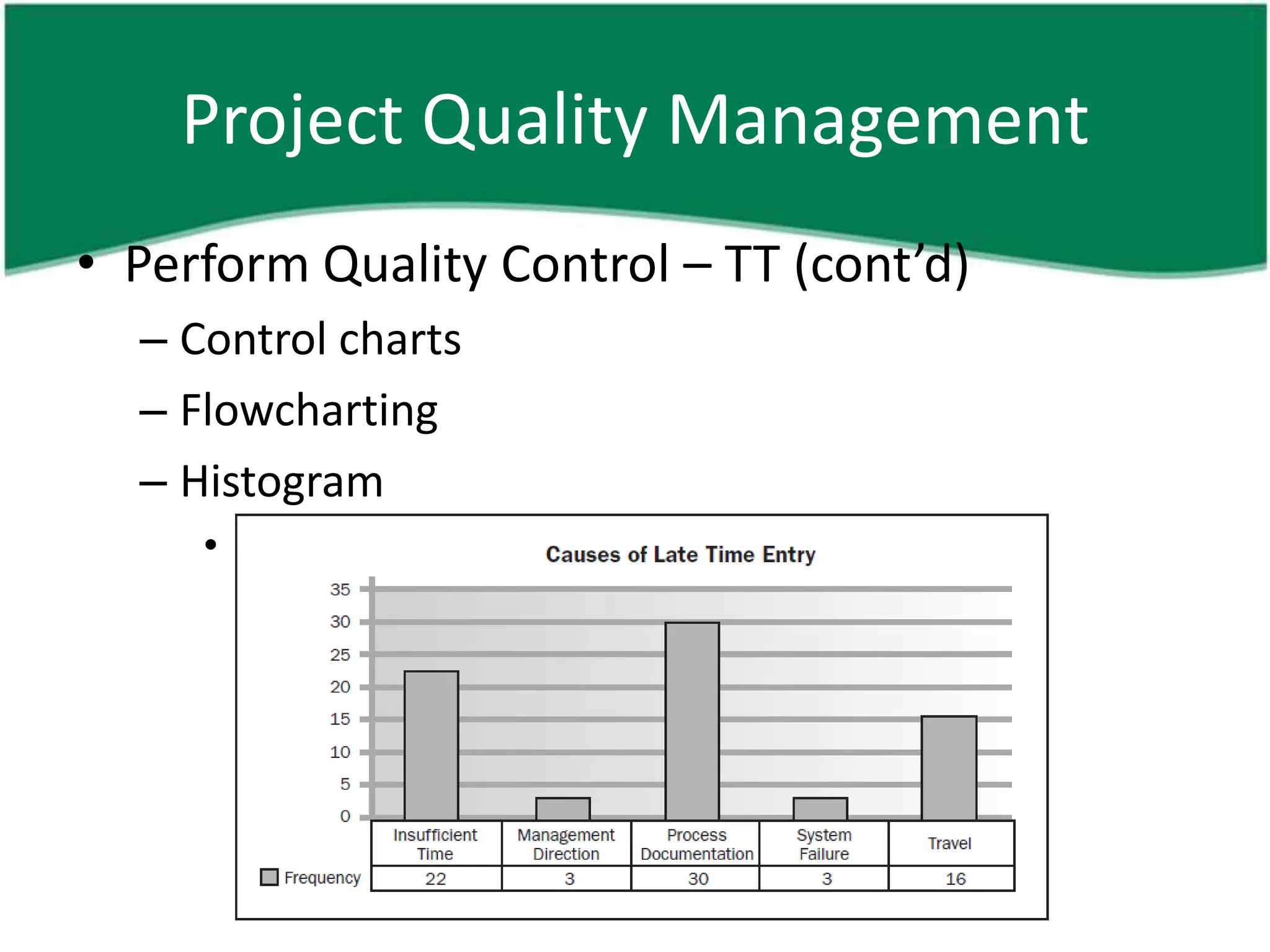

  – Histogram
     • To show occurrence / frequency of variables
Project Quality Management
• Perform Quality Control – TT (cont’d)

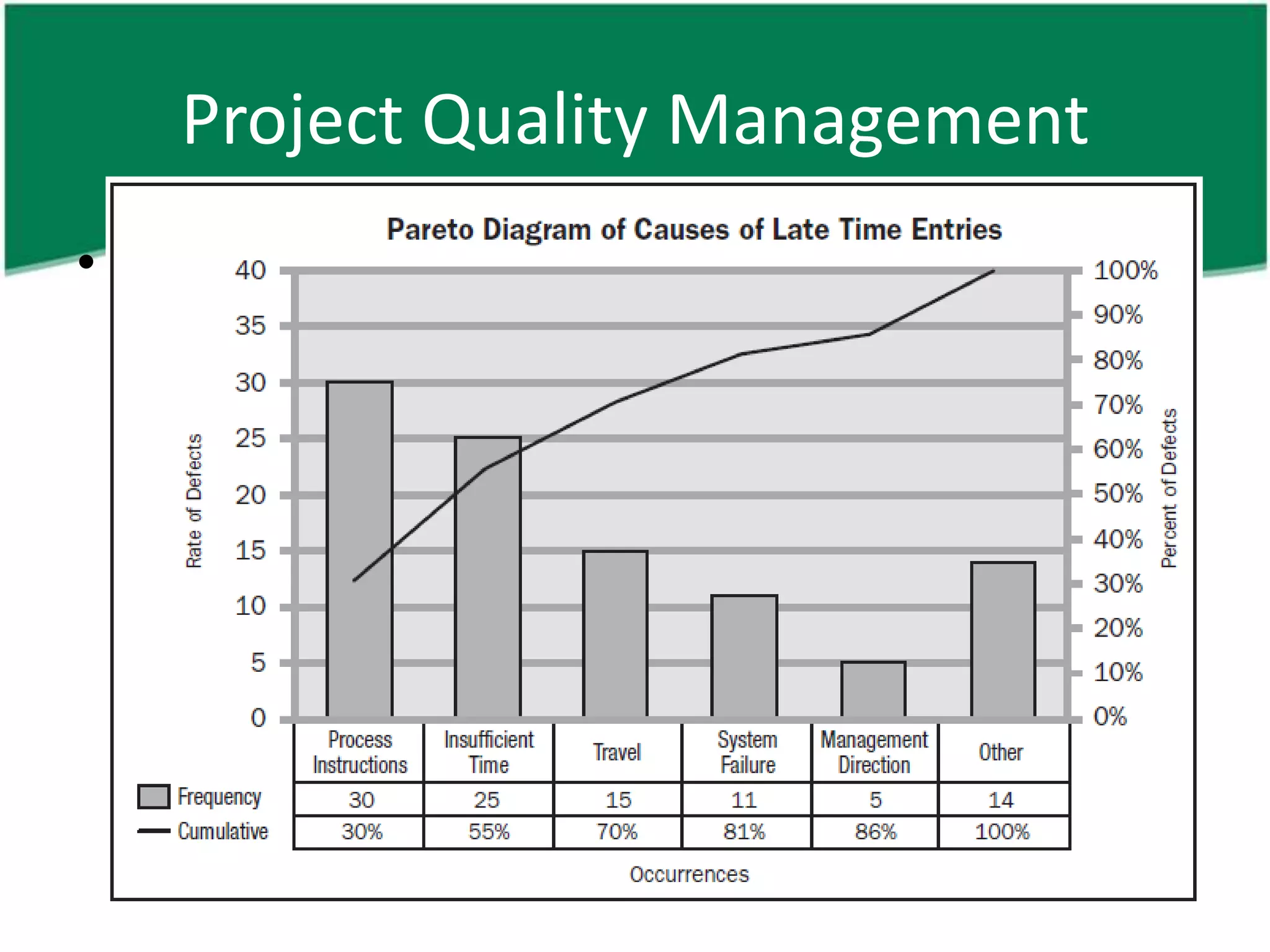

  – Pareto chart
     • A histogram ordered by frequency of occurrence
     • Applies rank ordering to focus on corrective actions
     • Developed conceptually to Pareto’s law: 80/20 principle
       where 80% of problems are due to 20% of causes
Project Quality Management

• Perform Quality Control – TT (cont’d)
  – Run chart
     • Similar to control chart but no limits
     • Shows history and pattern of variation
     • Is a form of a line graph plotted in order in which they
       occur
     • Shows trend
Project Quality Management
• Perform Quality Control – TT (cont’d)

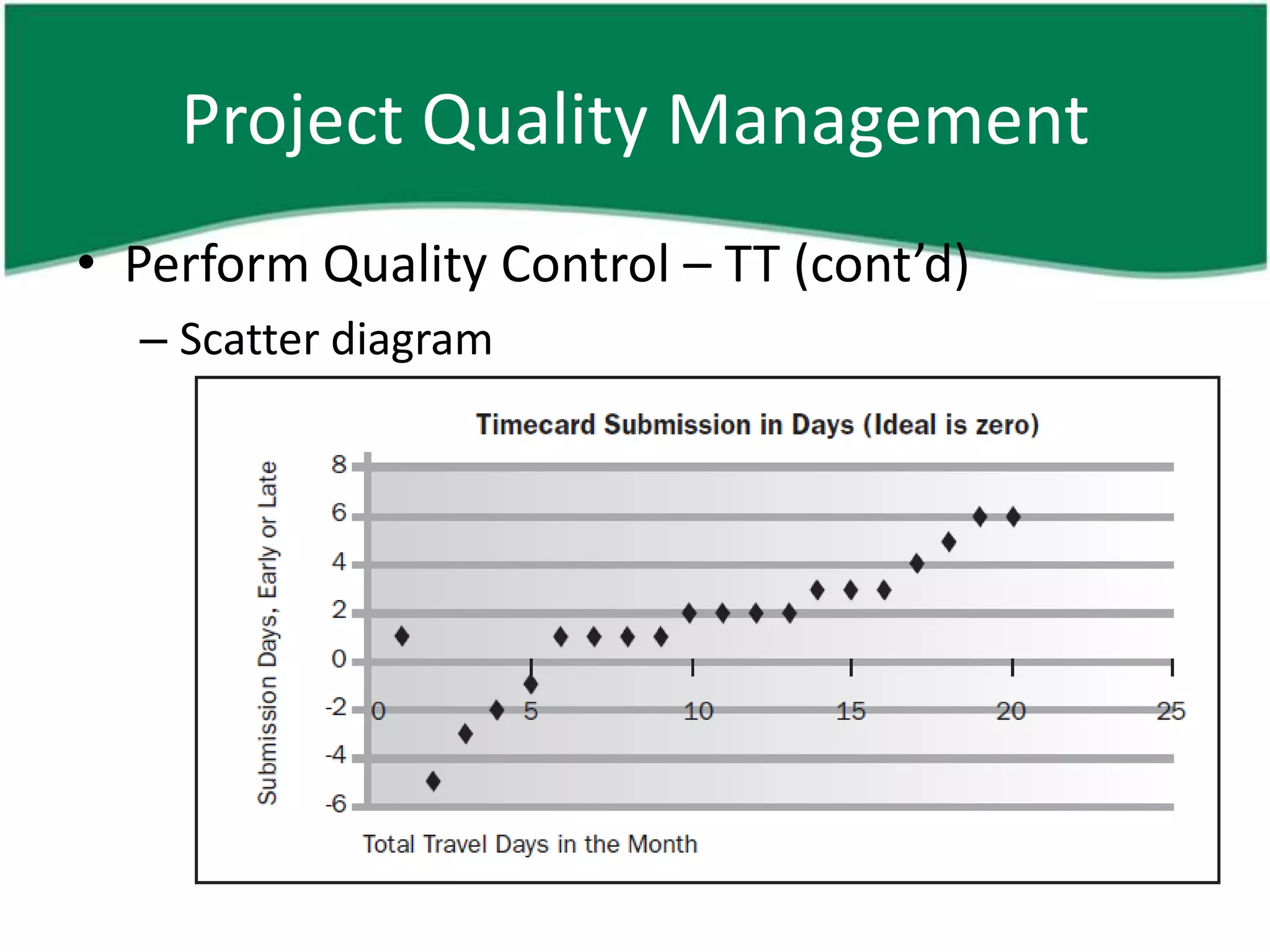

  – Scatter diagram
     • Shows relationship of 2 variables
     • To identify relationship between changes of 2 variables
     • The closer the points are to diagonal line, the more
       closely they are related
Project Quality Management
• Perform Quality Control – TT (cont’d)
  – Statistical sampling
  – Inspection
  – Approved CR review
Project Quality Management
• Perform Quality Control – O
  – Quality control measurements
  – Validated changes
  – Validated variables
  – OPA U
  – CR
  – PMP U
  – PD U

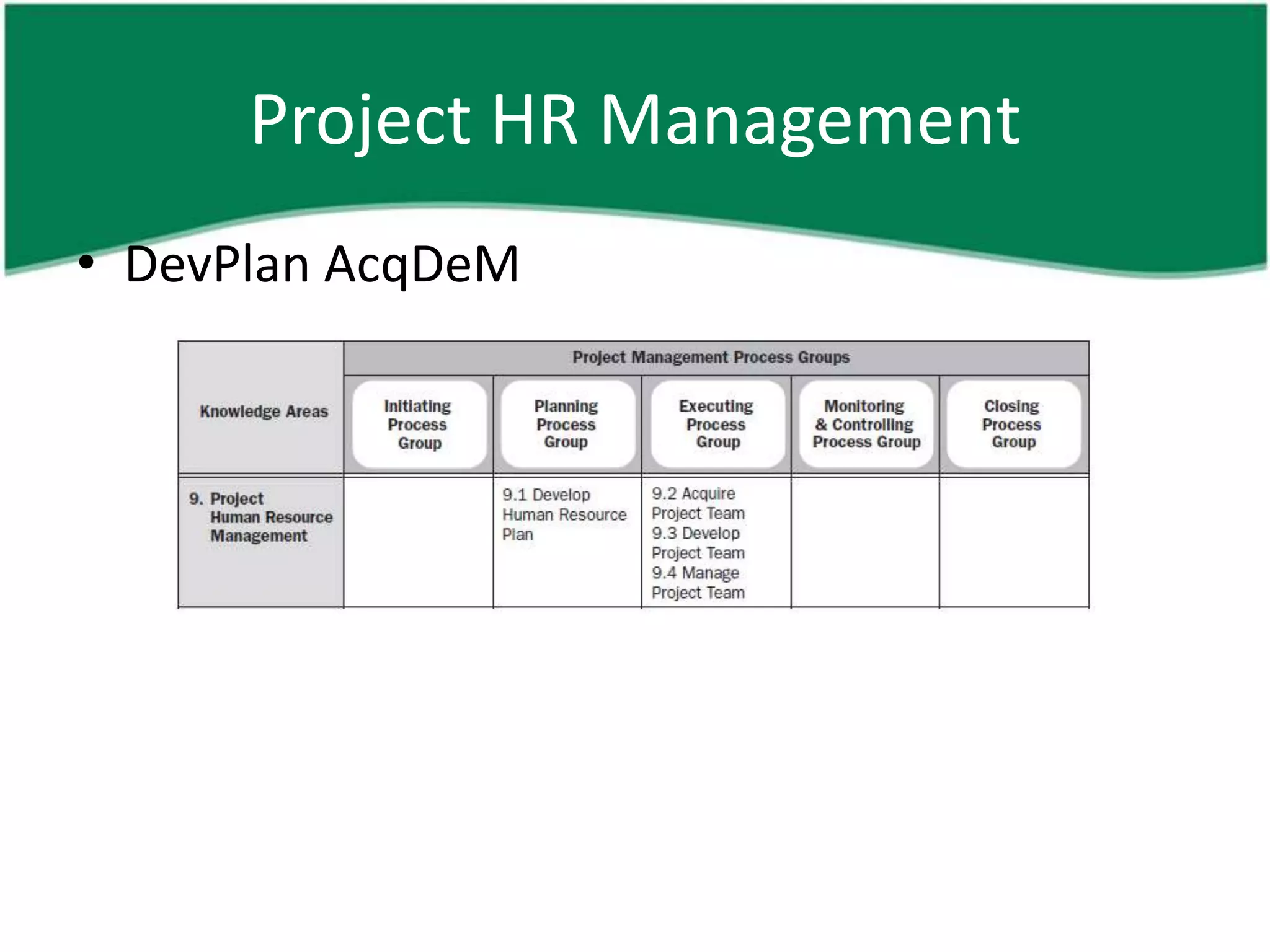

Project HR Management

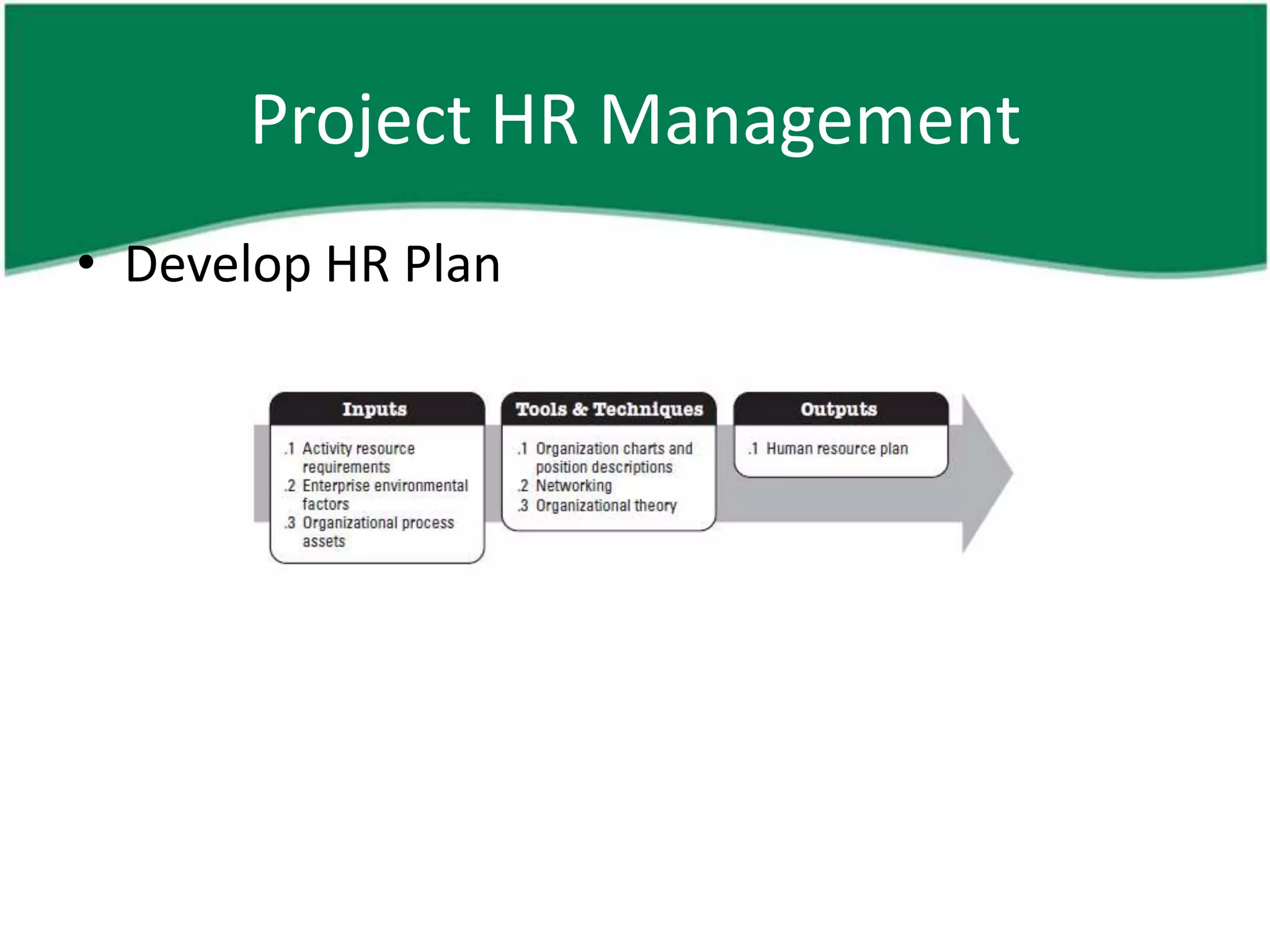

• DevPlan AcqDeM
Project HR Management

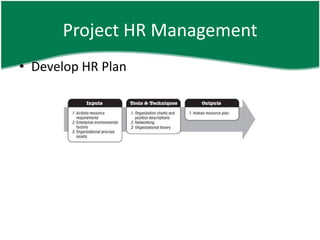

• Develop HR Plan
Project HR Management

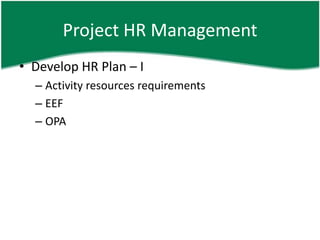

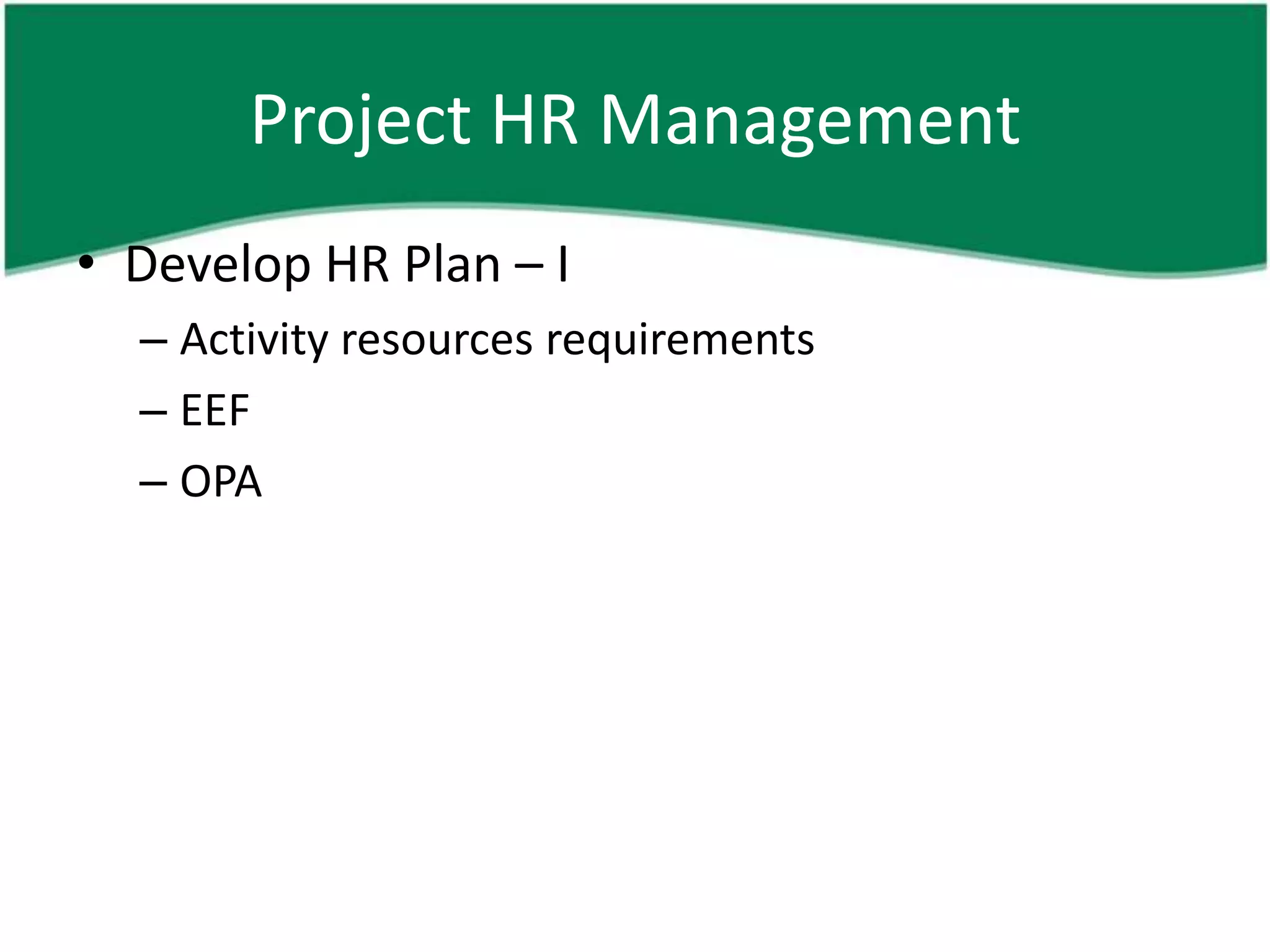

• Develop HR Plan – I
  – Activity resources requirements
  – EEF
  – OPA
Project HR Management

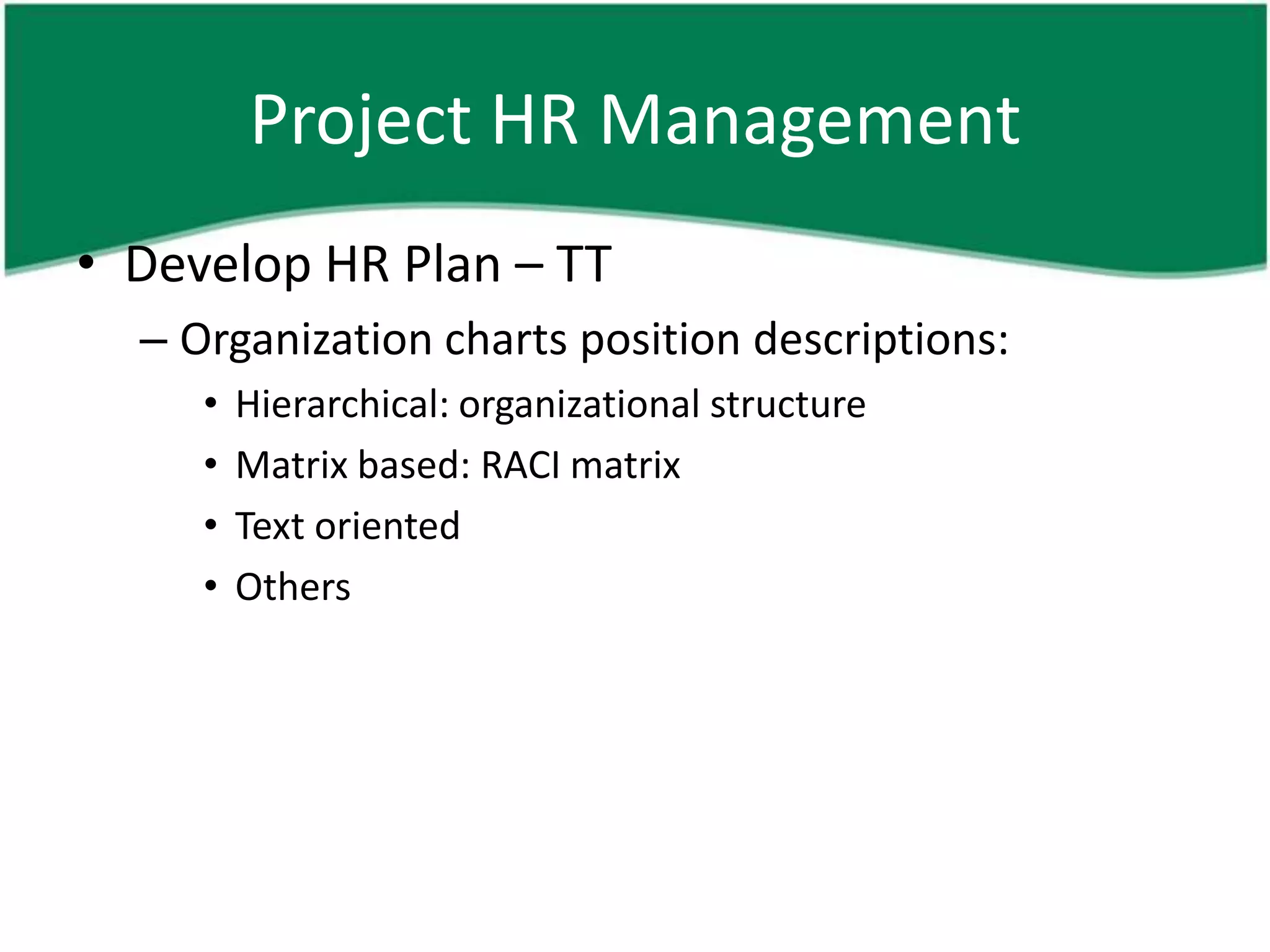

• Develop HR Plan – TT

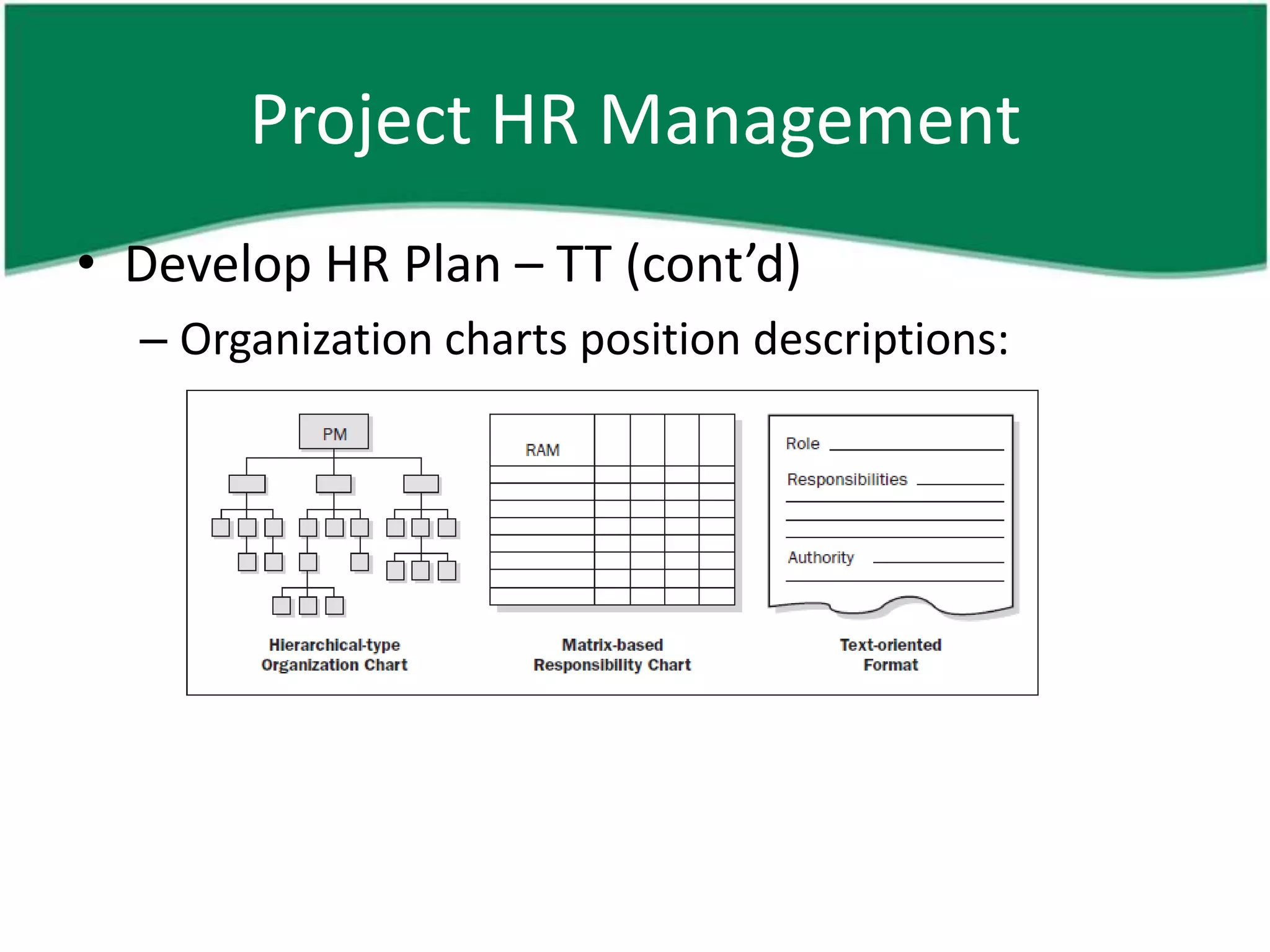

  – Organization charts position descriptions:
     •   Hierarchical: organizational structure
     •   Matrix based: RACI matrix
     •   Text oriented
     •   Others
Project HR Management
• Develop HR Plan – TT (cont’d)
  – Organization charts position descriptions:
Project HR Management
• Develop HR Plan – TT (cont’d)
  – Networking
  – Organizational theory
Project HR Management

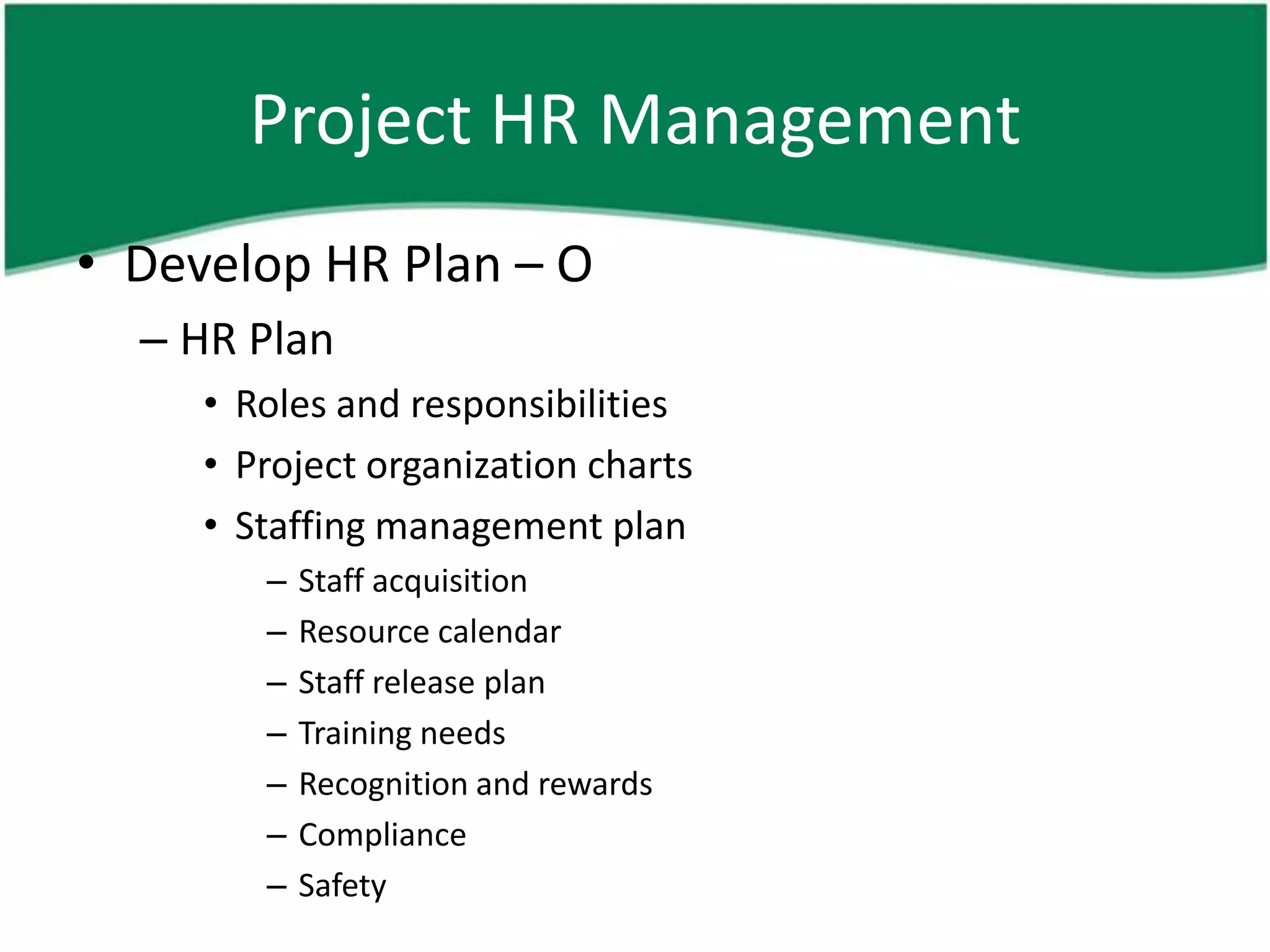

• Develop HR Plan – O
  – HR Plan
     • Roles and responsibilities
     • Project organization charts
     • Staffing management plan
        –   Staff acquisition
        –   Resource calendar
        –   Staff release plan
        –   Training needs
        –   Recognition and rewards
        –   Compliance
        –   Safety
Project HR Management

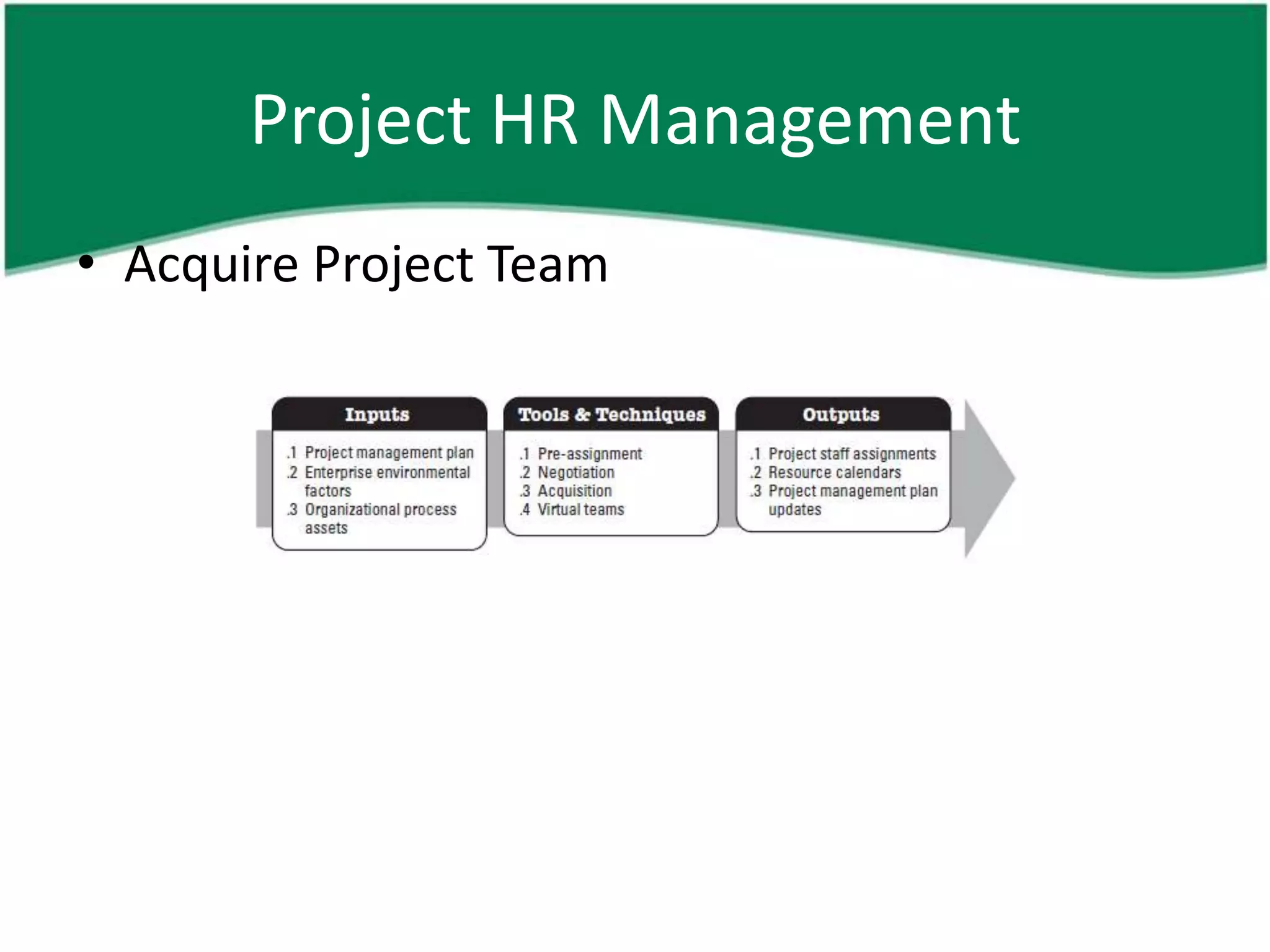

• Acquire Project Team
Project HR Management

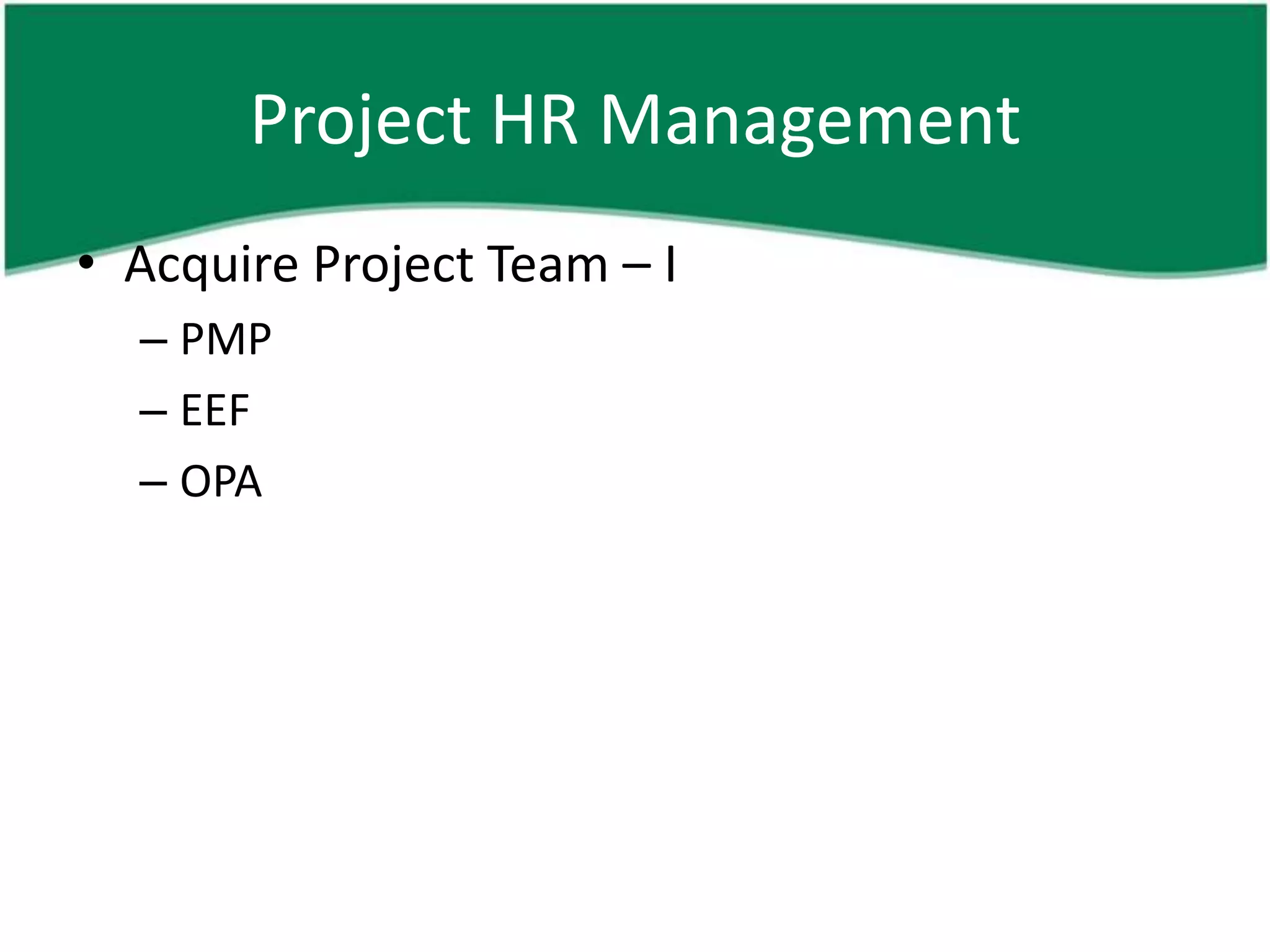

• Acquire Project Team – I
  – PMP
  – EEF
  – OPA
Project HR Management

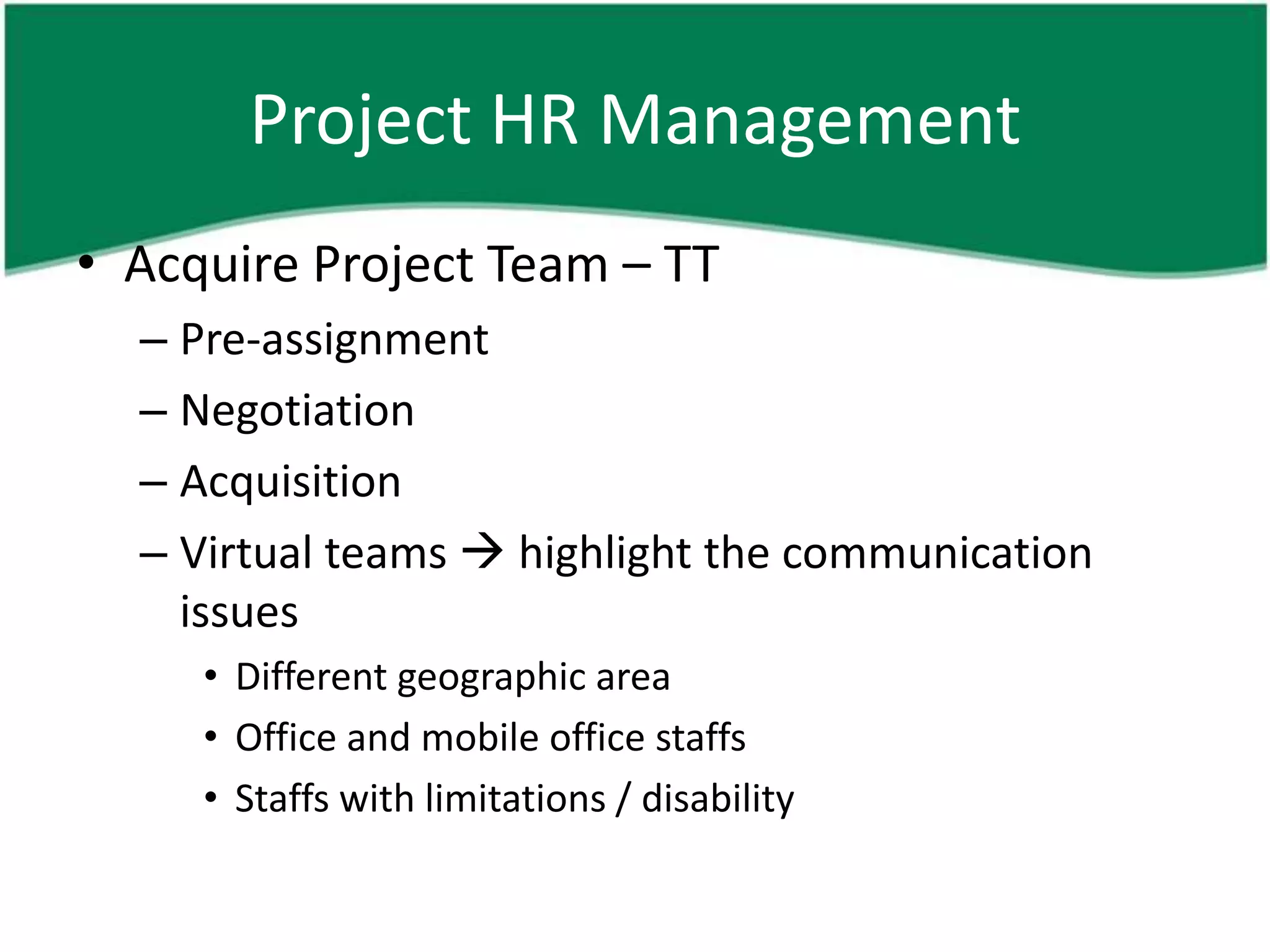

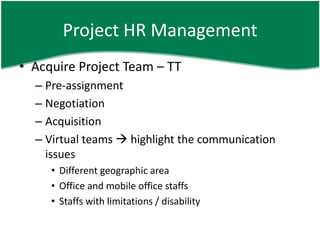

• Acquire Project Team – TT
  – Pre-assignment
  – Negotiation
  – Acquisition
  – Virtual teams  highlight the communication
    issues
     • Different geographic area
     • Office and mobile office staffs
     • Staffs with limitations / disability
Project HR Management

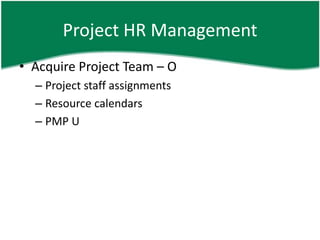

• Acquire Project Team – O
  – Project staff assignments
  – Resource calendars
  – PMP U
Project HR Management
• Develop Project Team
  – Improve team’s competencies/skills, interaction,
    and overall environment to enhance project
    performance
  – Highlight about teamwork despite cultural /
    language differences
  – Highlight about team’s bond and trust to raise
    morale and lower conflict
  – To create a dynamic and cohesive team culture
Project HR Management

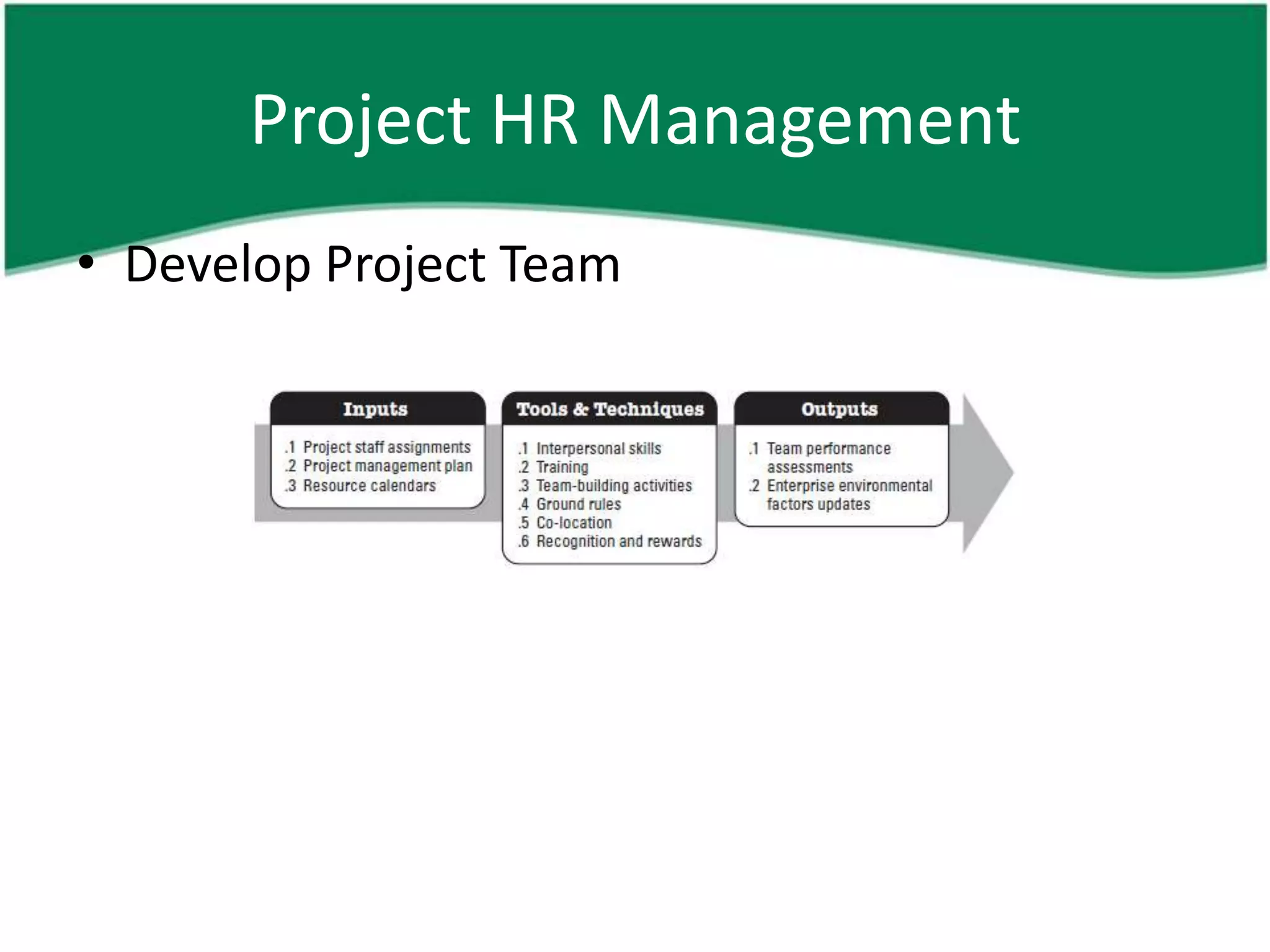

• Develop Project Team
Project HR Management

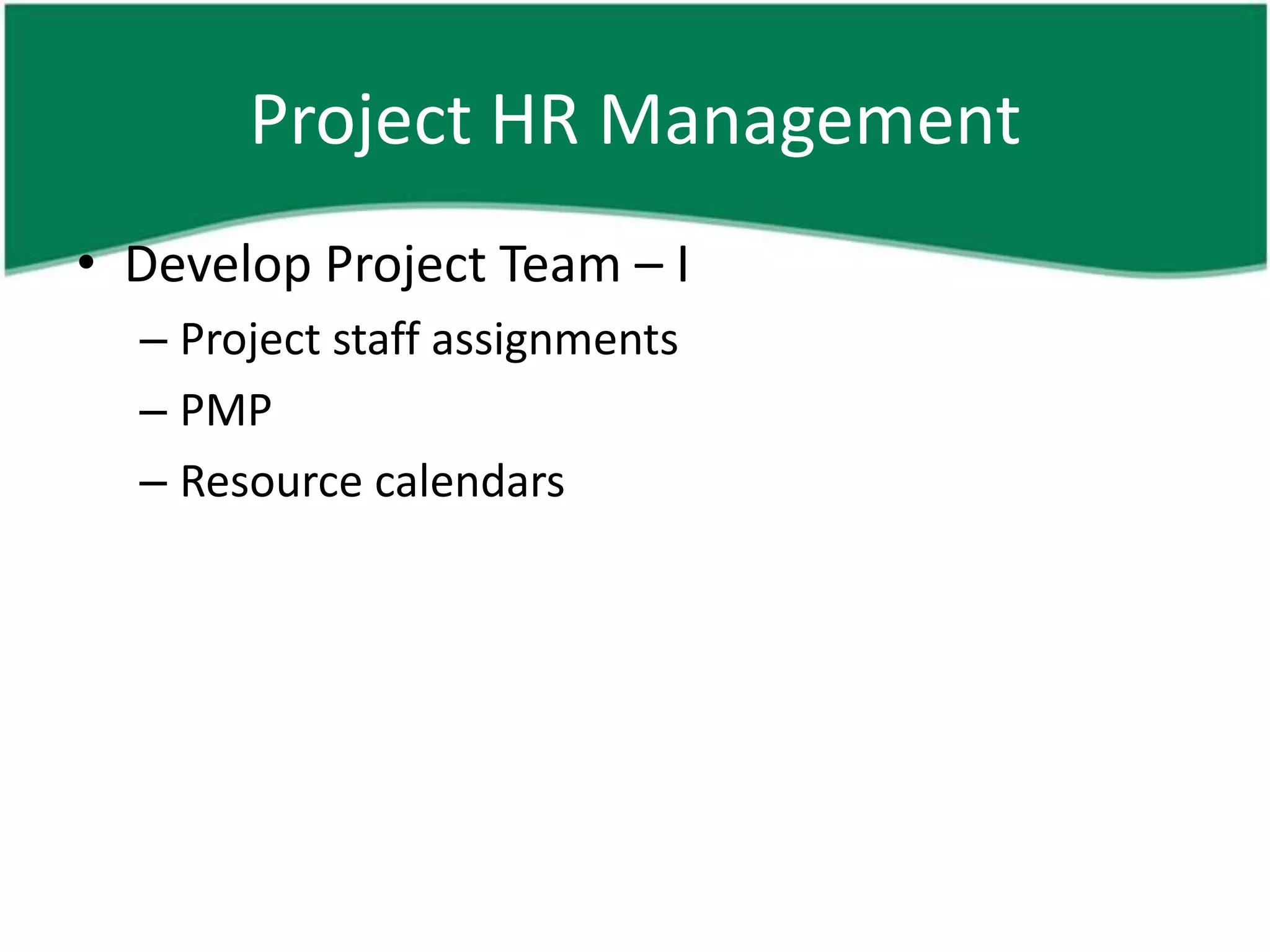

• Develop Project Team – I
  – Project staff assignments
  – PMP
  – Resource calendars
Project HR Management

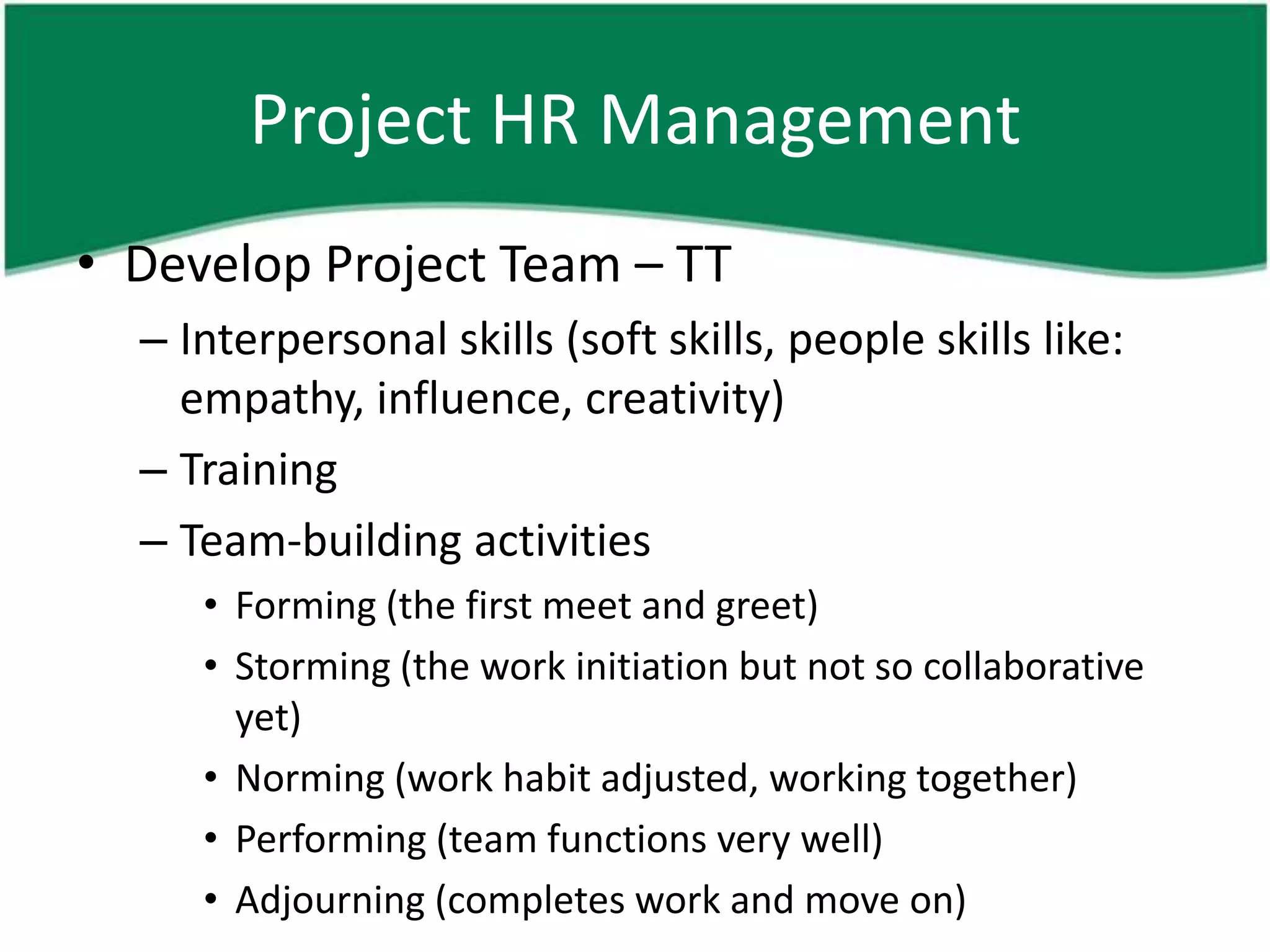

• Develop Project Team – TT
  – Interpersonal skills (soft skills, people skills like:
    empathy, influence, creativity)
  – Training
  – Team-building activities
     • Forming (the first meet and greet)
     • Storming (the work initiation but not so collaborative
       yet)
     • Norming (work habit adjusted, working together)
     • Performing (team functions very well)
     • Adjourning (completes work and move on)
Project HR Management
• Develop Project Team – TT (cont’d)
  – Ground rules
  – Co-location
  – Recognition and rewards
Project HR Management

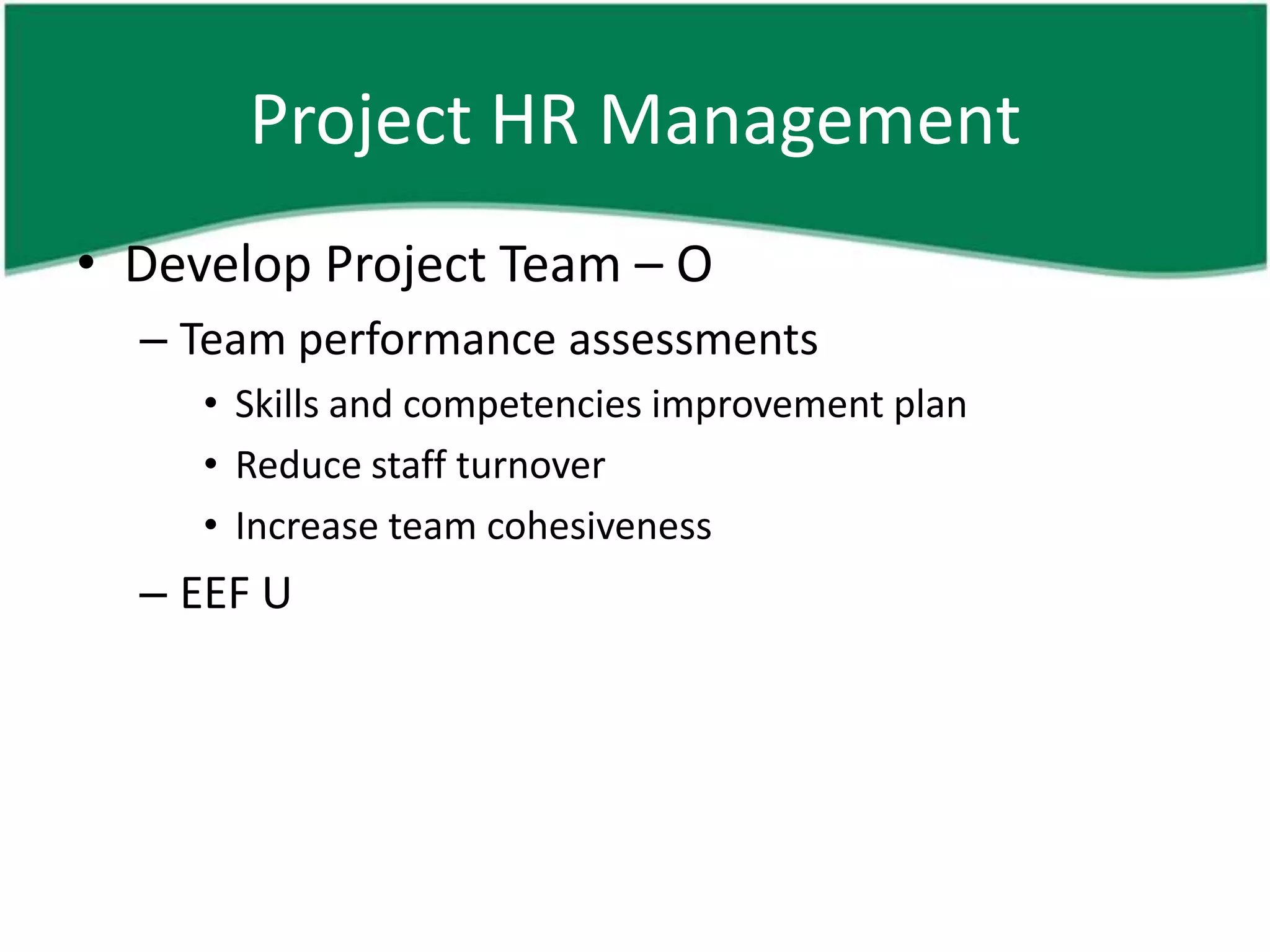

• Develop Project Team – O
  – Team performance assessments
     • Skills and competencies improvement plan
     • Reduce staff turnover
     • Increase team cohesiveness
  – EEF U
Project HR Management

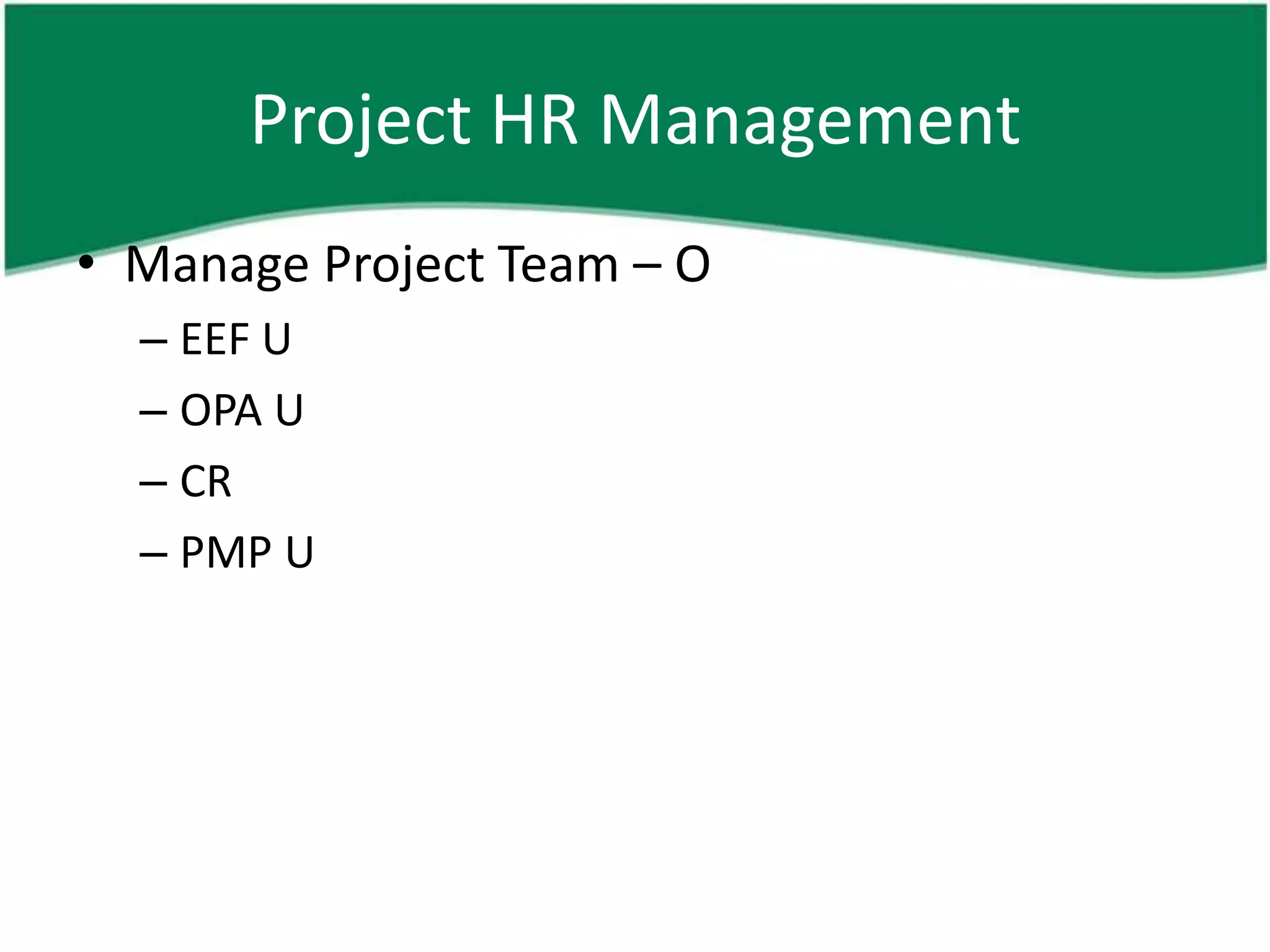

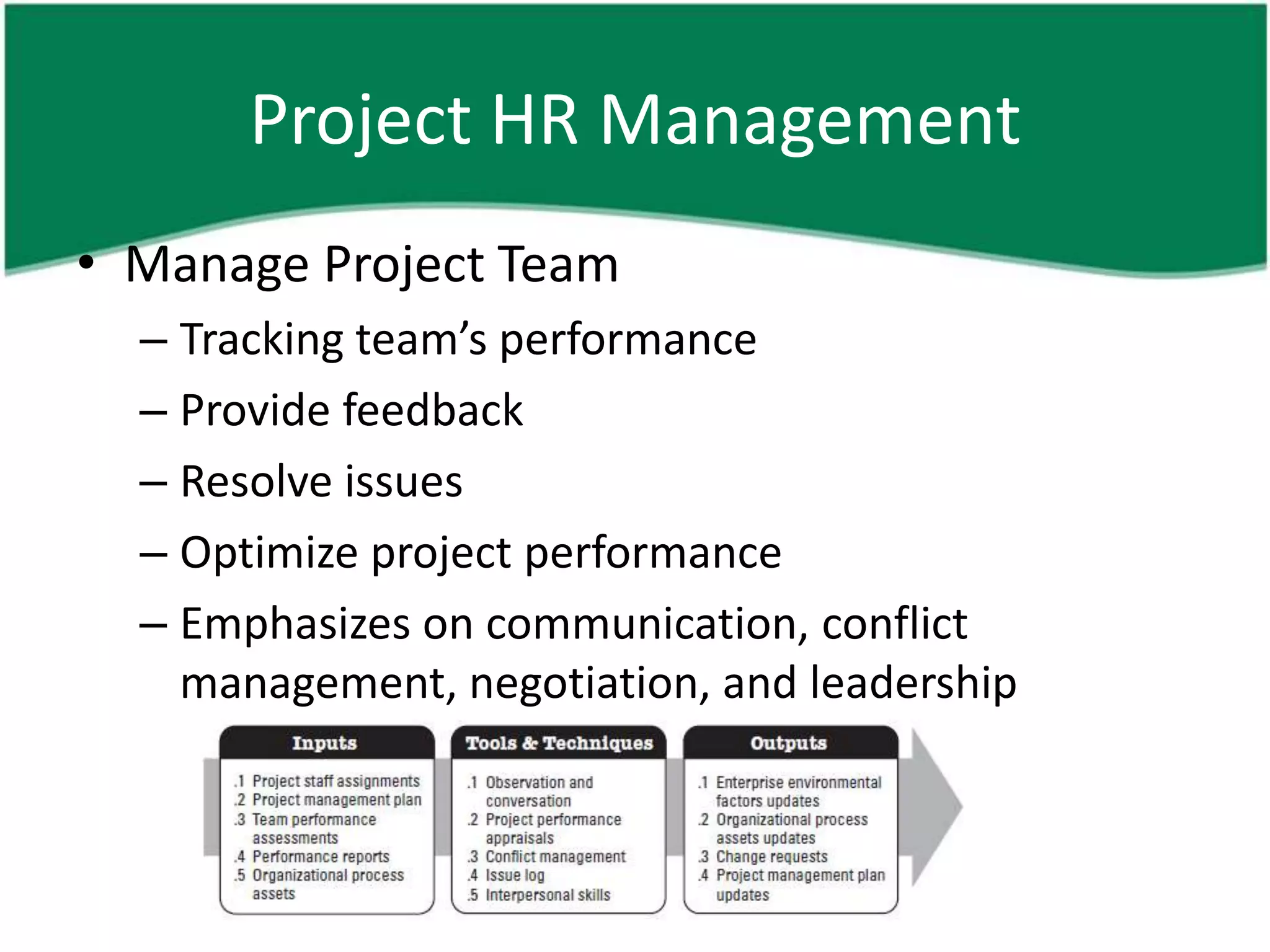

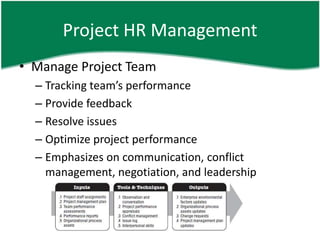

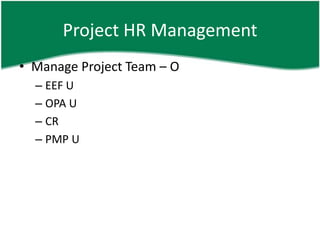

• Manage Project Team
  – Tracking team’s performance
  – Provide feedback
  – Resolve issues
  – Optimize project performance
  – Emphasizes on communication, conflict
    management, negotiation, and leadership
Project HR Management
• Manage Project Team – I
  – Project staff assignments
  – PMP
  – Team performance assessments
  – Performance reports
  – OPA
Project HR Management

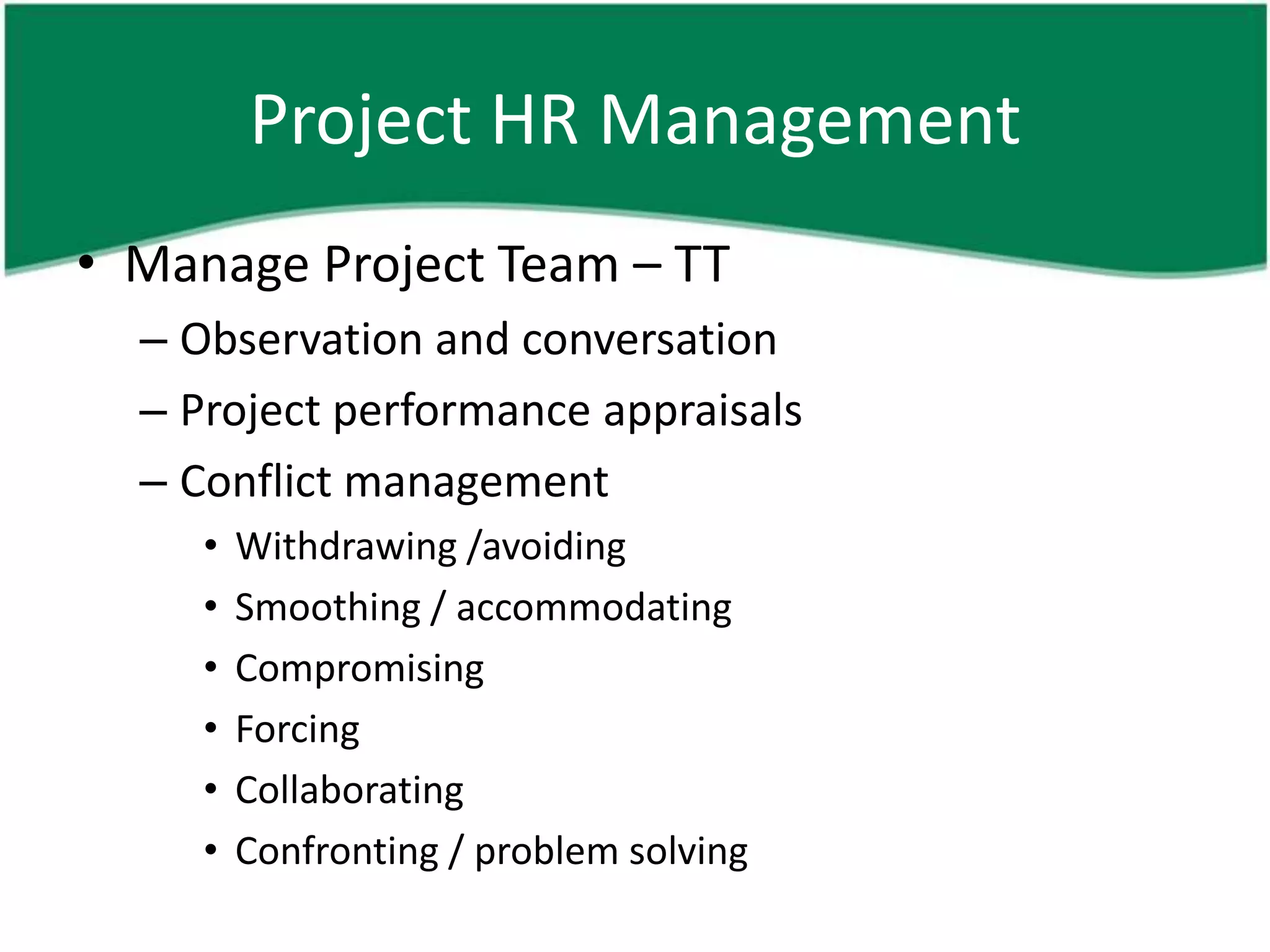

• Manage Project Team – TT
  – Observation and conversation
  – Project performance appraisals
  – Conflict management
     •   Withdrawing /avoiding
     •   Smoothing / accommodating
     •   Compromising
     •   Forcing
     •   Collaborating
     •   Confronting / problem solving

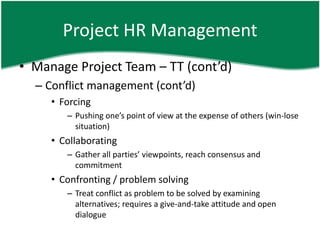

Project HR Management

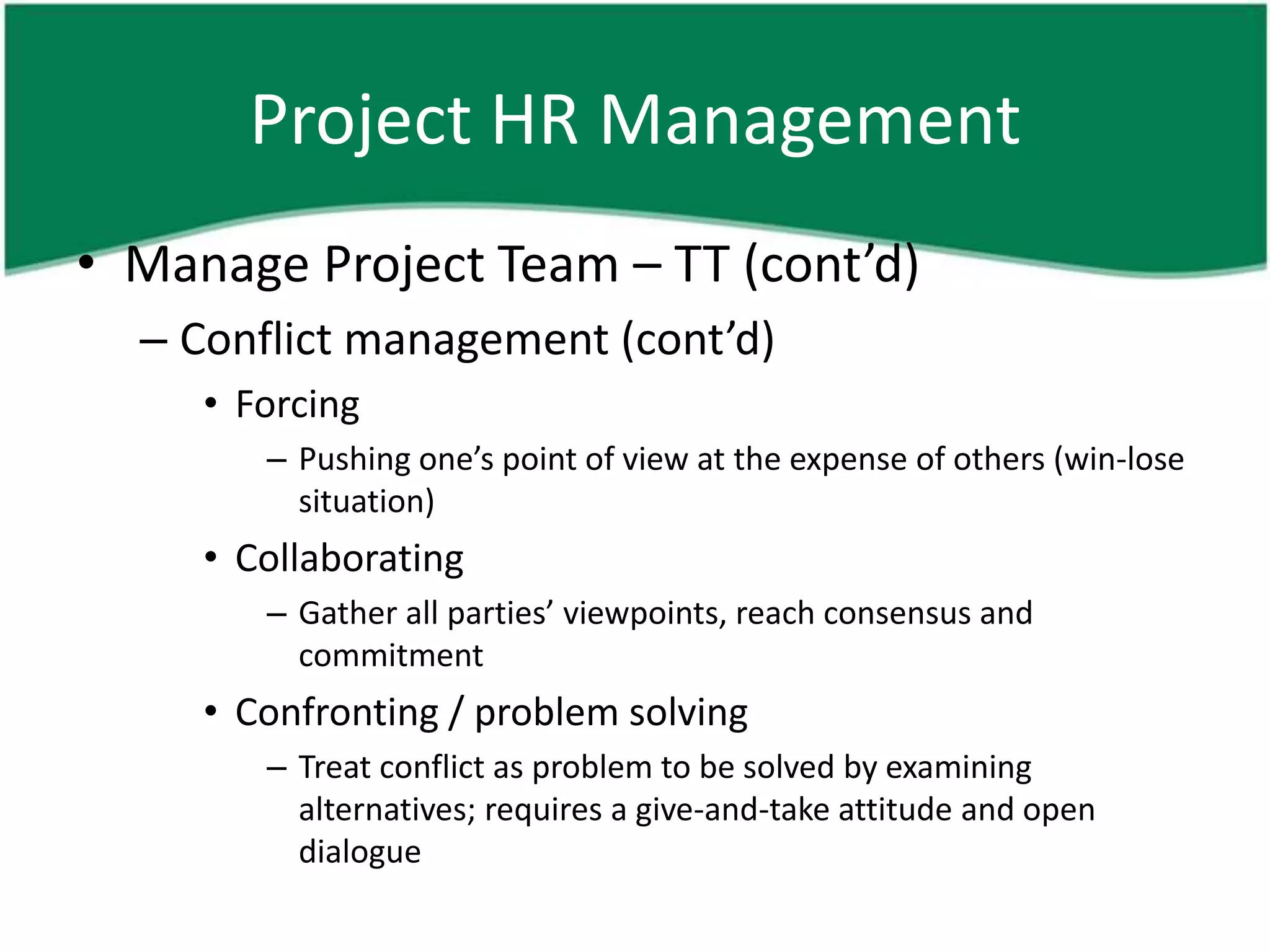

• Manage Project Team – TT (cont’d)

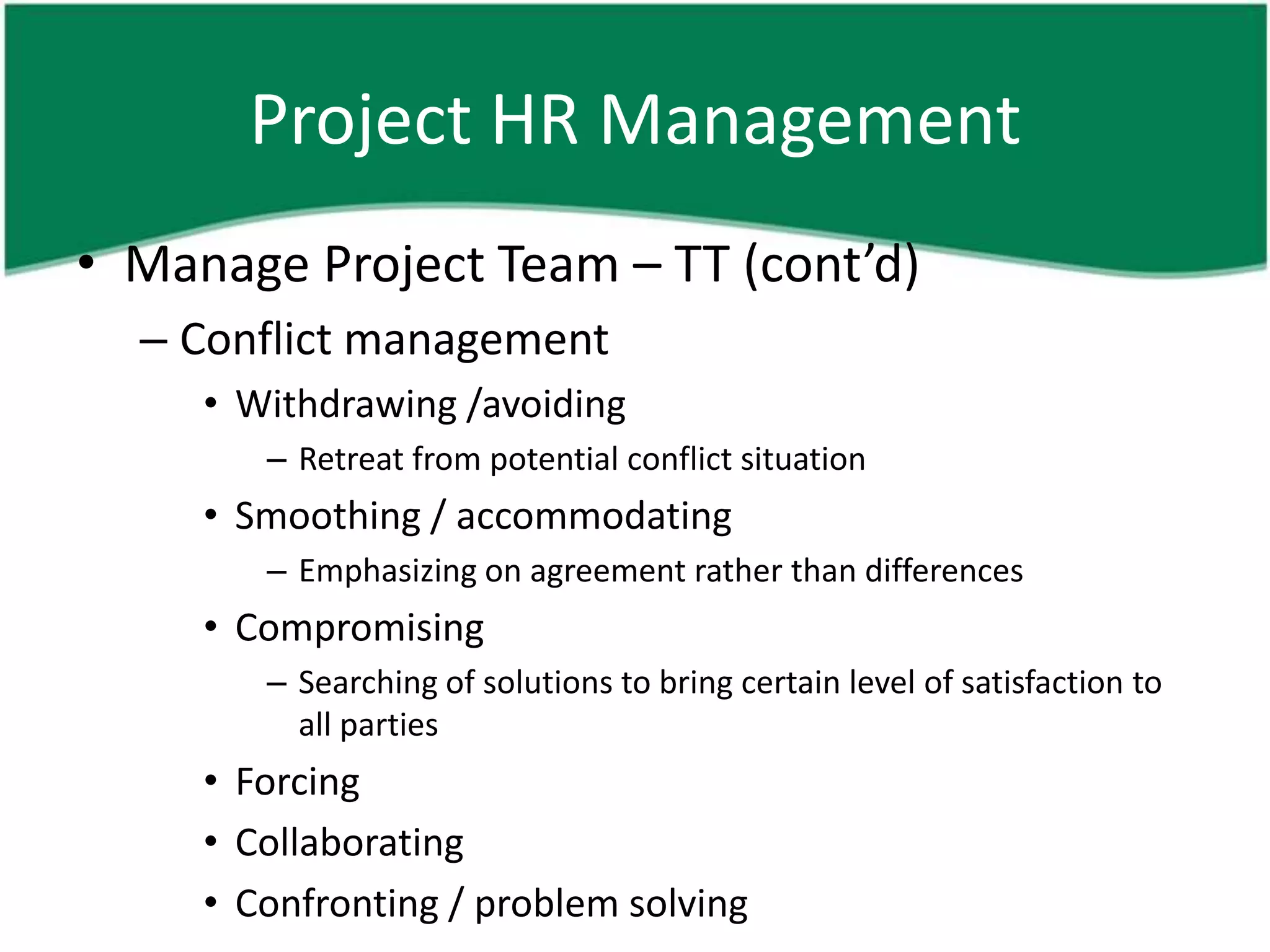

  – Conflict management
     • Withdrawing /avoiding
        – Retreat from potential conflict situation
     • Smoothing / accommodating
        – Emphasizing on agreement rather than differences
     • Compromising
        – Searching of solutions to bring certain level of satisfaction to
          all parties
     • Forcing
     • Collaborating
     • Confronting / problem solving
Project HR Management
• Manage Project Team – TT (cont’d)
  – Conflict management (cont’d)
     • Forcing
        – Pushing one’s point of view at the expense of others (win-lose
          situation)
     • Collaborating
        – Gather all parties’ viewpoints, reach consensus and
          commitment
     • Confronting / problem solving
        – Treat conflict as problem to be solved by examining
          alternatives; requires a give-and-take attitude and open
          dialogue
Project HR Management
• Manage Project Team – TT (cont’d)
  – Issue log
  – Interpersonal skills
     •   Leadership
     •   Influencing (persuasive and considerate)
     •   Listening skills
     •   Effective decision making
Project HR Management
• Manage Project Team – O
  – EEF U
  – OPA U
  – CR
  – PMP U
Project HR Management
• Motivating your team

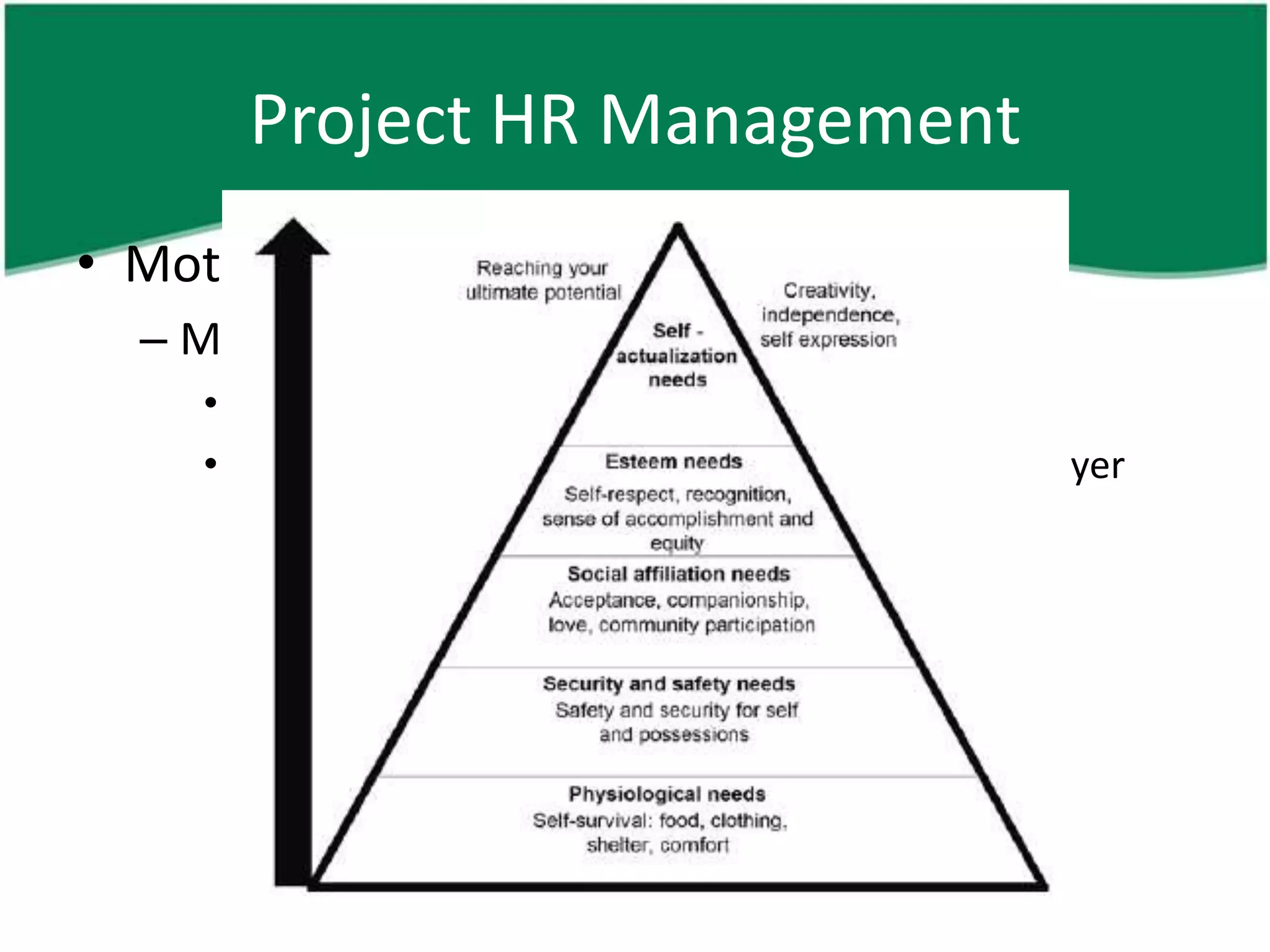

  – Maslow’s hierarchy of needs
     • People have layers of needs
     • Fill the lower layer first before filling the upper layer
Project HR Management
• Motivating your team (cont’d)

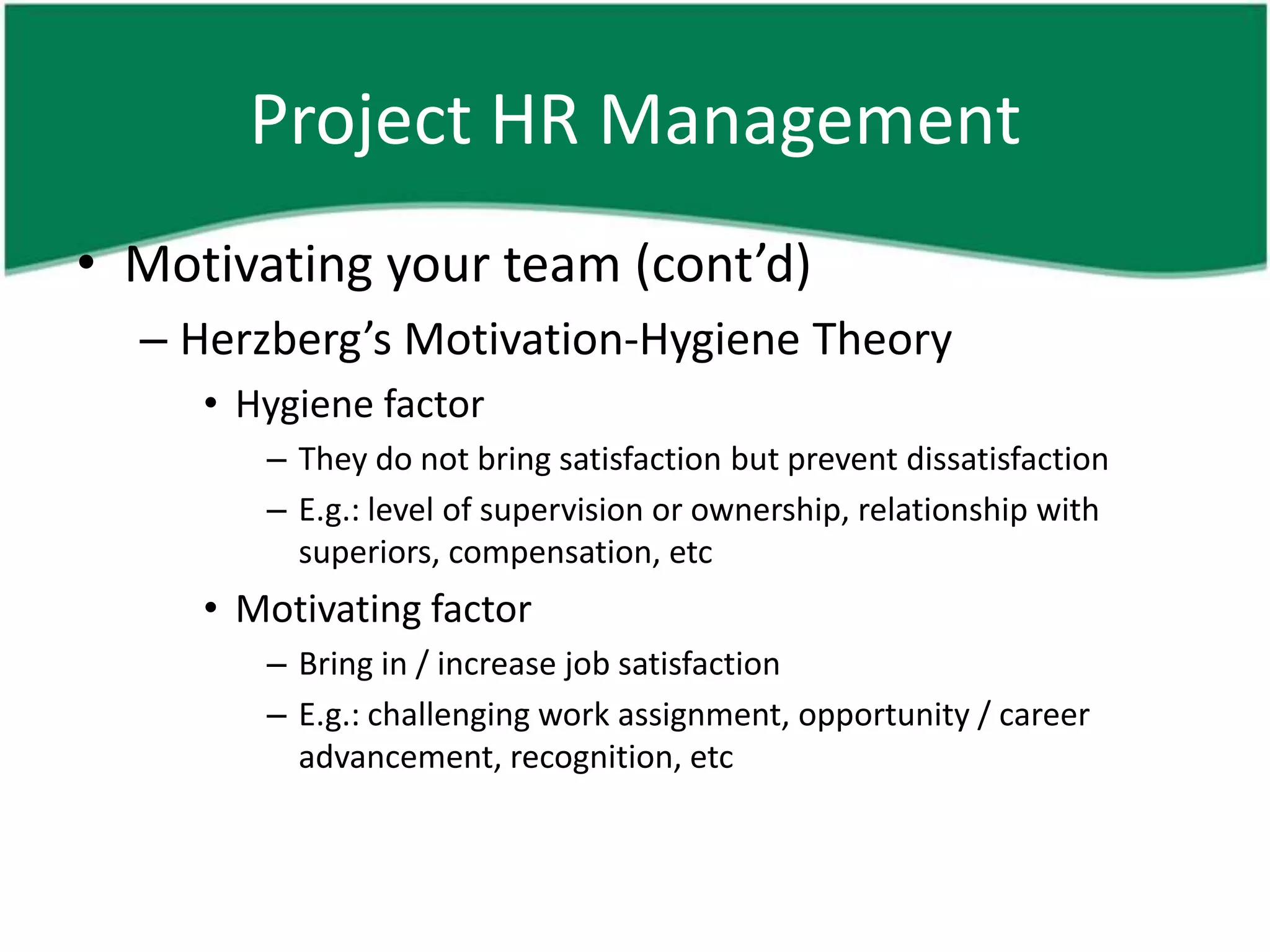

  – Herzberg’s Motivation-Hygiene Theory
     • Hygiene factor
        – They do not bring satisfaction but prevent dissatisfaction
        – E.g.: level of supervision or ownership, relationship with
          superiors, compensation, etc
     • Motivating factor
        – Bring in / increase job satisfaction
        – E.g.: challenging work assignment, opportunity / career
          advancement, recognition, etc
Project HR Management

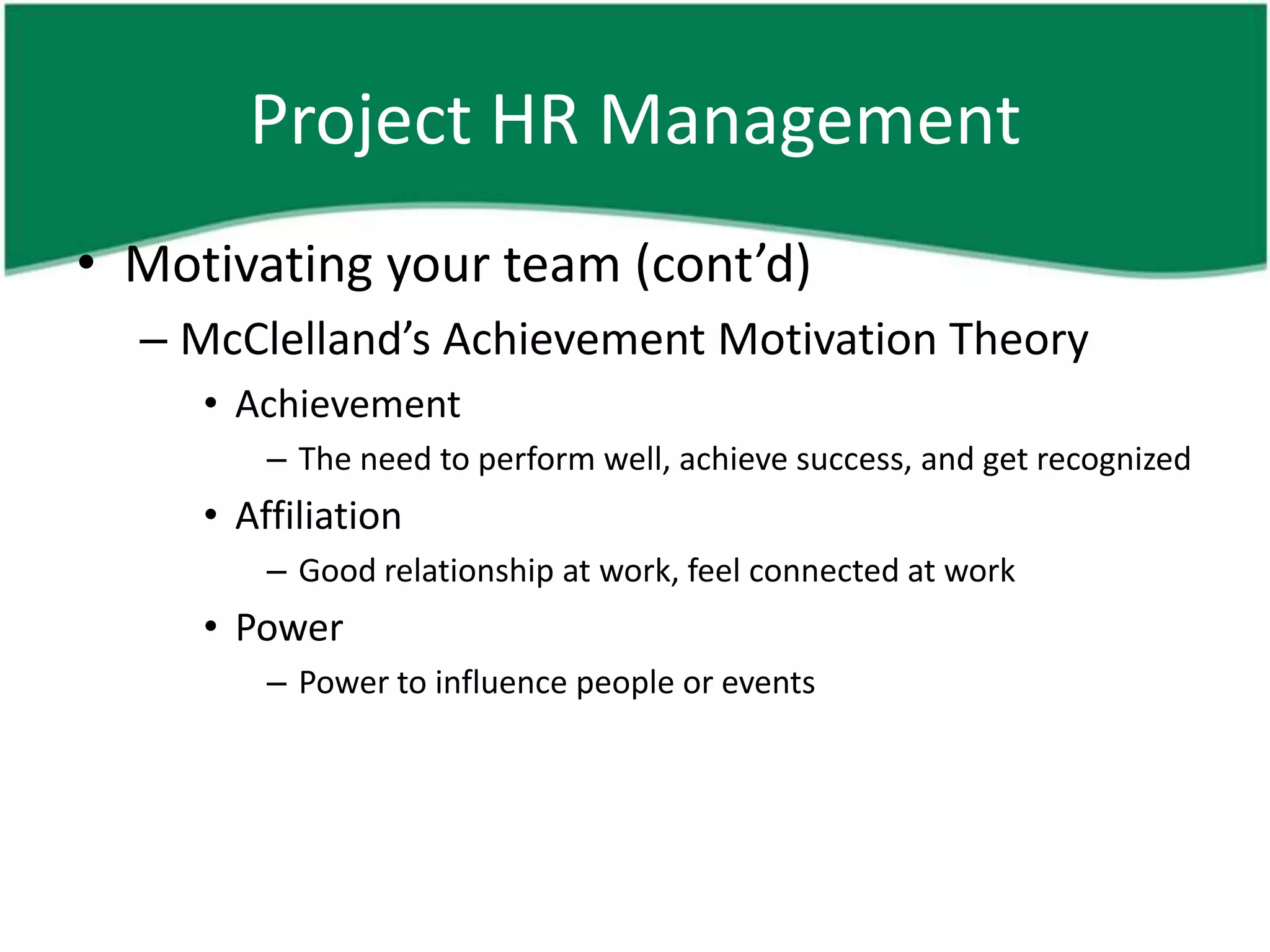

• Motivating your team (cont’d)
  – McClelland’s Achievement Motivation Theory
     • Achievement
         – The need to perform well, achieve success, and get recognized
     • Affiliation
         – Good relationship at work, feel connected at work
     • Power
         – Power to influence people or events
Project HR Management
• Motivating your team (cont’d)

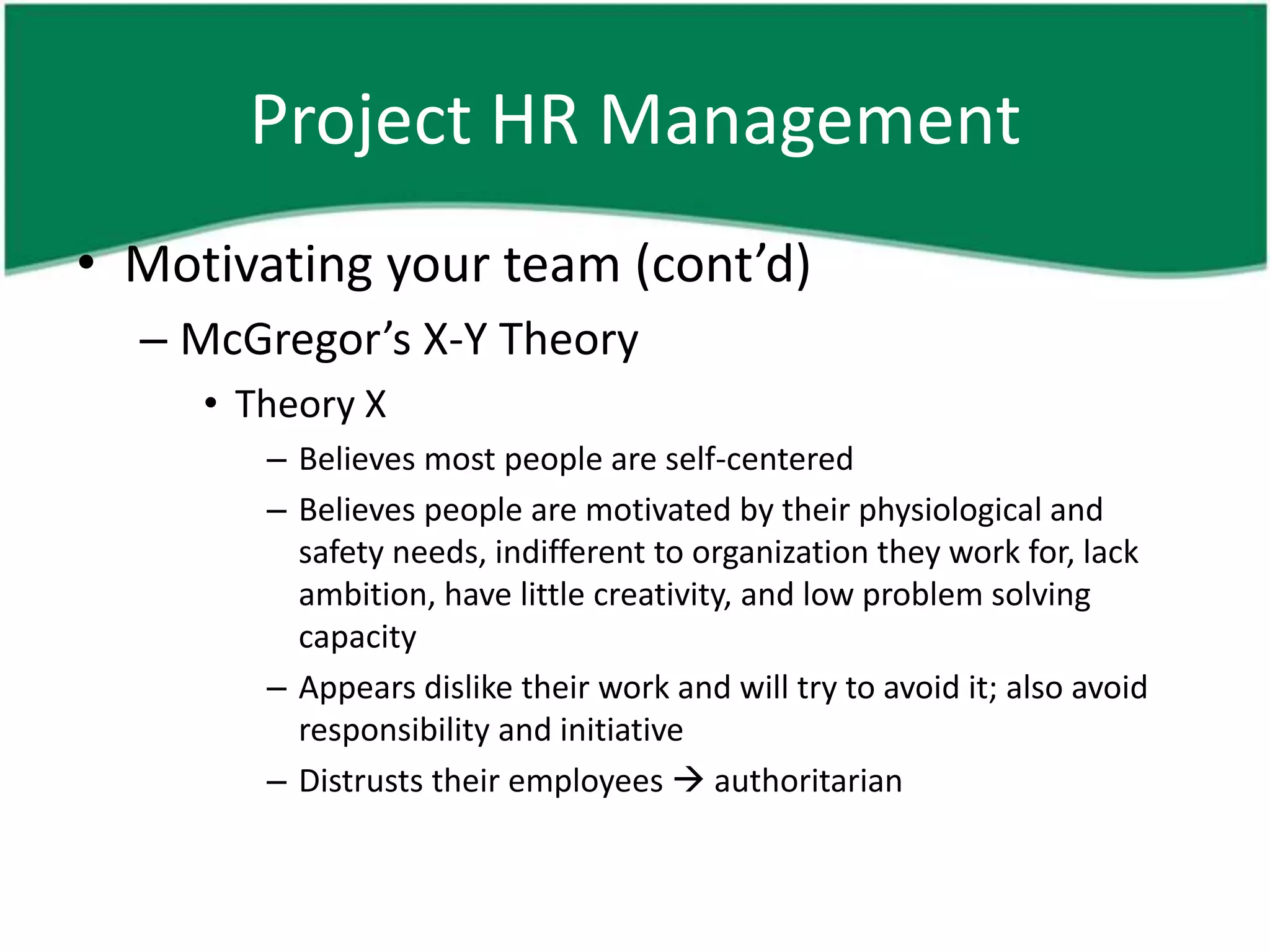

  – McGregor’s X-Y Theory
     • Theory X
        – Believes most people are self-centered
        – Believes people are motivated by their physiological and
          safety needs, indifferent to organization they work for, lack
          ambition, have little creativity, and low problem solving
          capacity
        – Appears dislike their work and will try to avoid it; also avoid
          responsibility and initiative
        – Distrusts their employees  authoritarian
Project HR Management
• Motivating your team (cont’d)
  – McGregor’s X-Y Theory
     • Theory Y
        – Trusts their employees
        – Believes people are discipline, high performers, committed to
          meet organization’s needs they work for, like to take
          responsibility and high initiative
        – Tends to provide more freedom and opportunity for career
          growth
Project HR Management

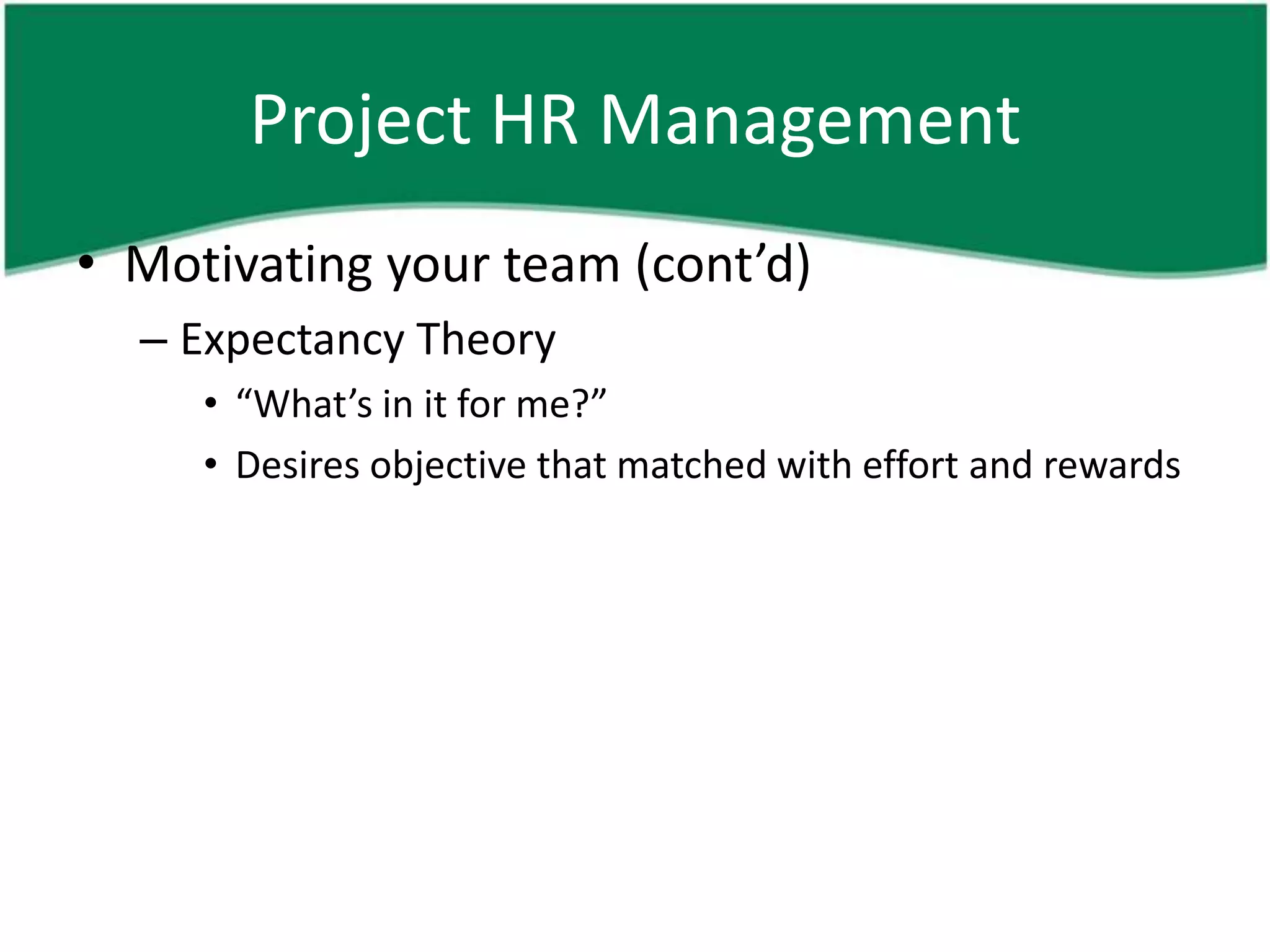

• Motivating your team (cont’d)

  – Expectancy Theory
     • “What’s in it for me?”
     • Desires objective that matched with effort and rewards
Sample Questions

1. What is the name of a quality planning
  technique that involves comparing the results
  of similar activities?
A. Brainstorming
B. Benchmarking
C. Cost/benefit analysis
D. Quality metrics
Sample Questions

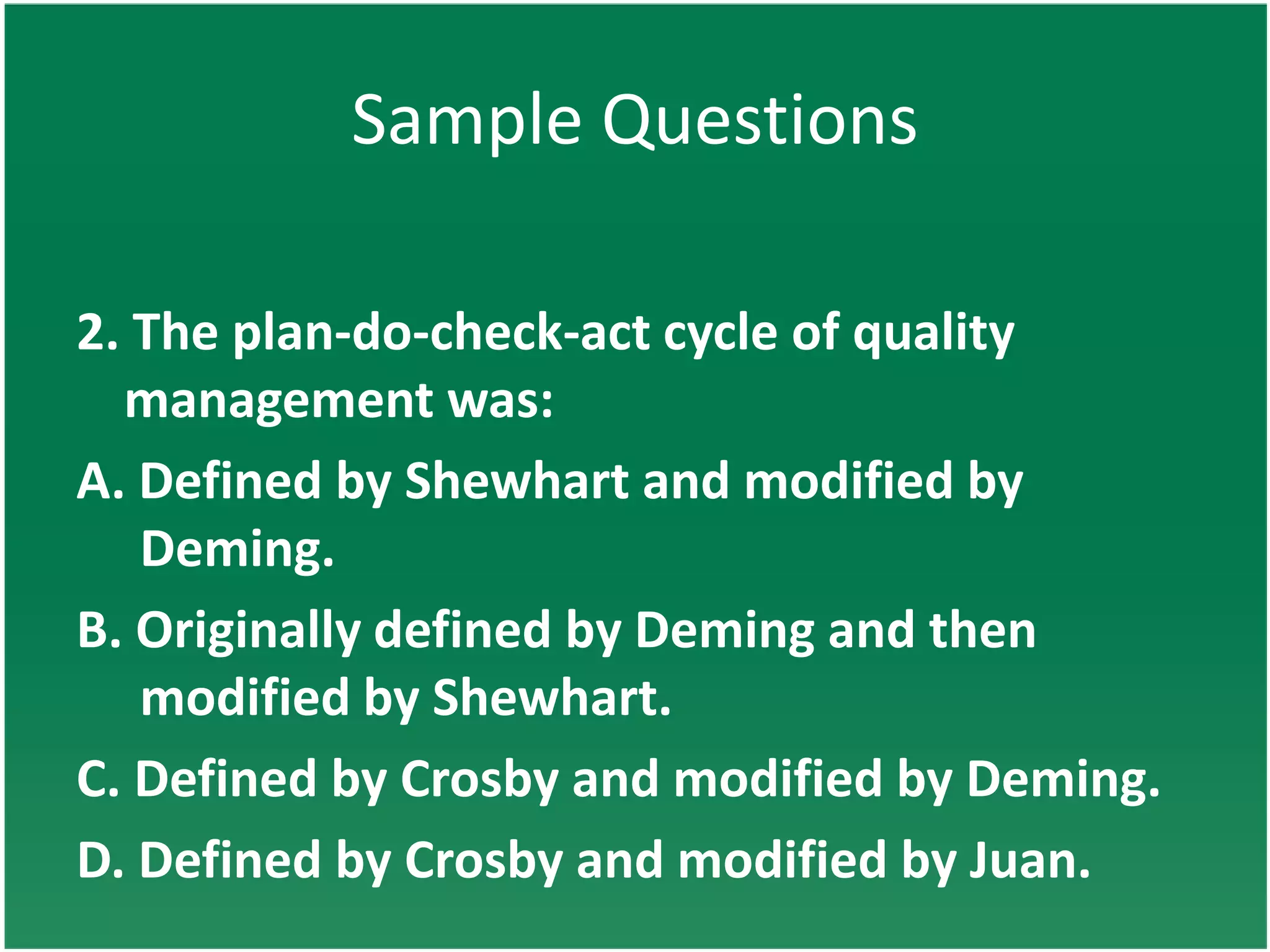

2. The plan-do-check-act cycle of quality
  management was:
A. Defined by Shewhart and modified by
   Deming.
B. Originally defined by Deming and then
   modified by Shewhart.
C. Defined by Crosby and modified by Deming.
D. Defined by Crosby and modified by Juan.
Sample Questions

3. One of the fundamental tenets of modern quality
   management is:
A. Inspect the quality and then build it in.
B. There is no need to design and build in the quality
   until you do the inspection, if it’s needed.
C. Break all rules: Deliver the product in a timely
   fashion and then work on the quality.
D. Plan, design, and build in quality as opposed to
   inspecting it in.
Sample Questions

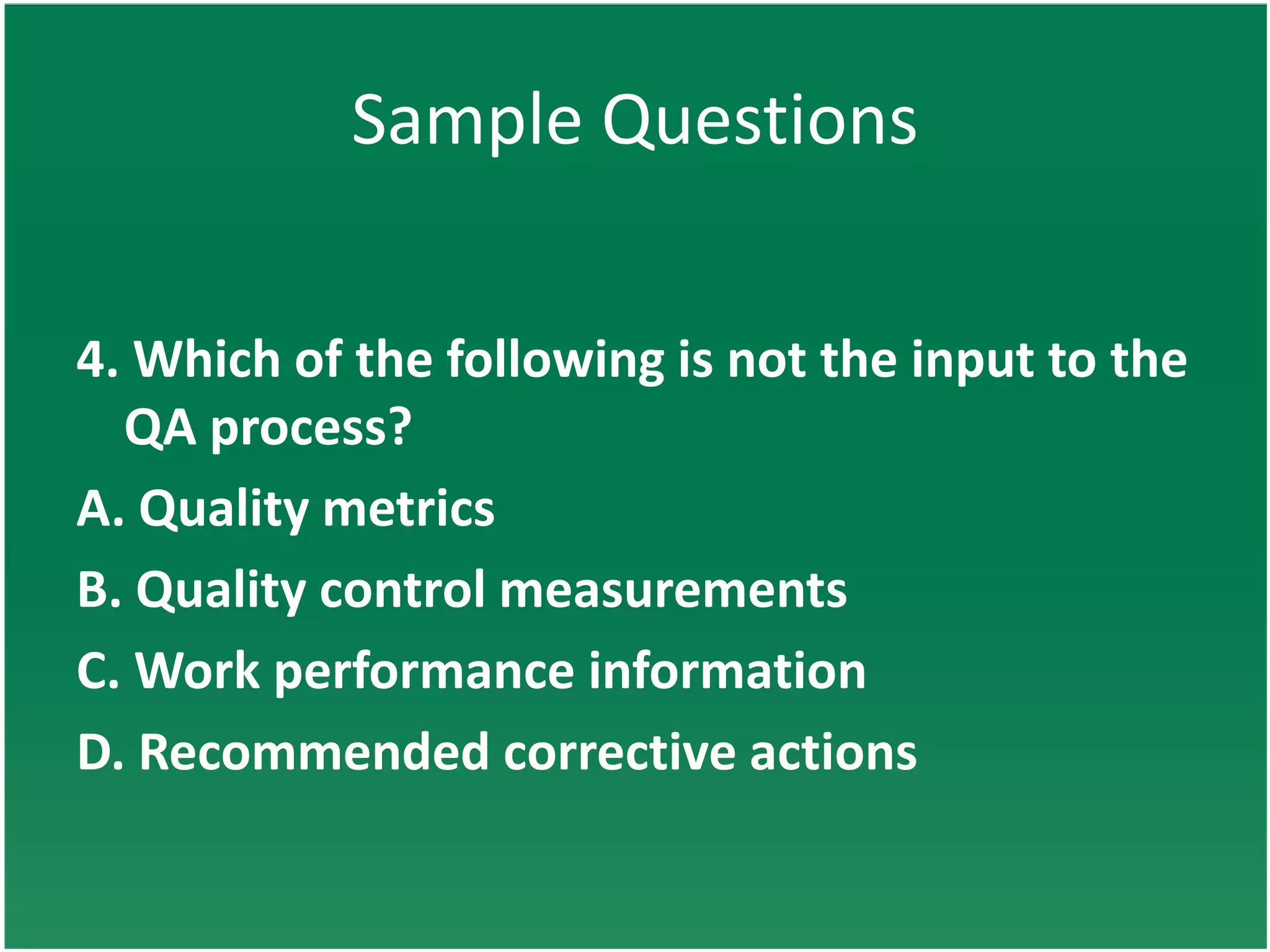

4. Which of the following is not the input to the
  QA process?
A. Quality metrics
B. Quality control measurements
C. Work performance information
D. Recommended corrective actions
Sample Questions

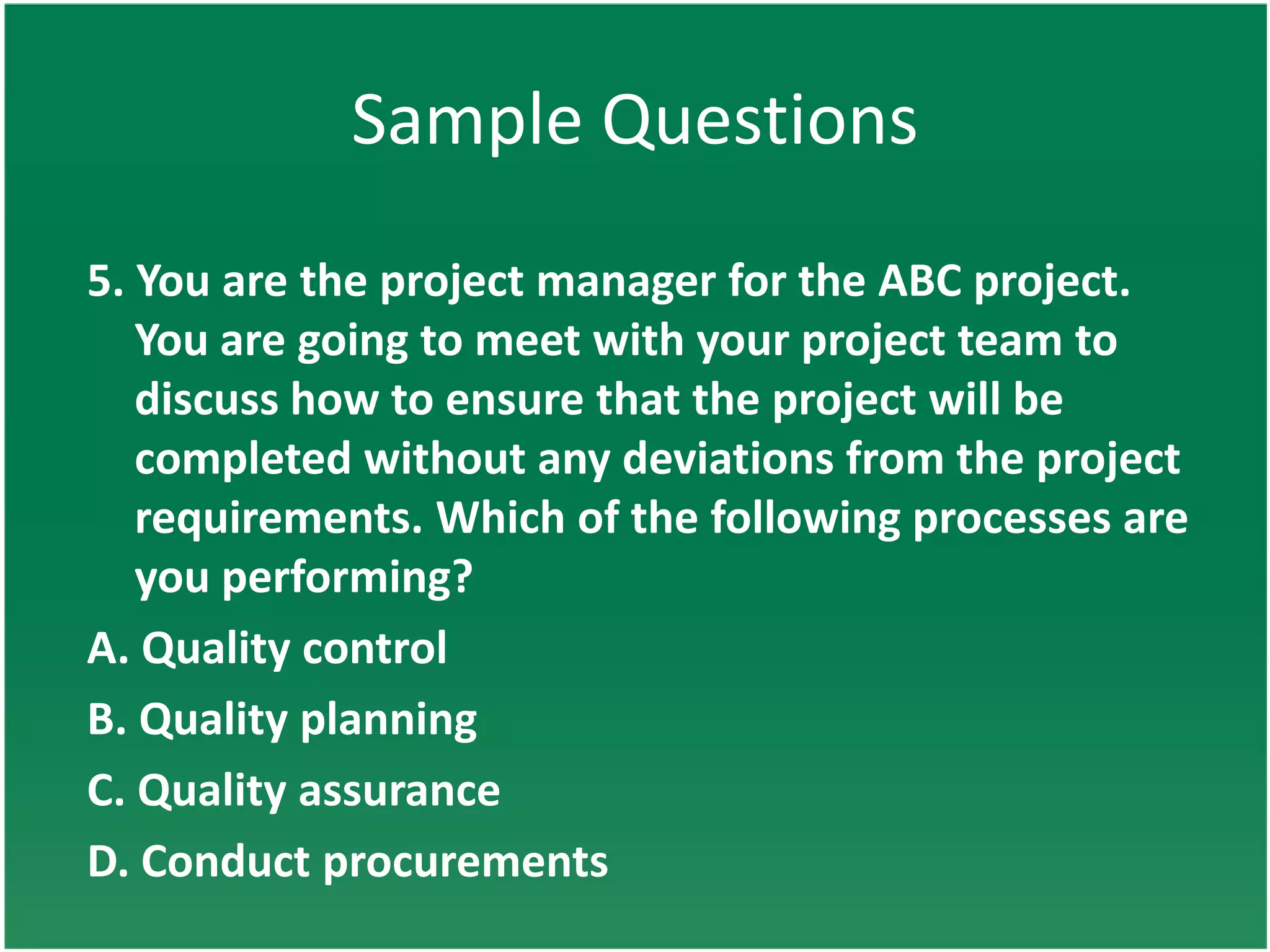

5. You are the project manager for the ABC project.
   You are going to meet with your project team to
   discuss how to ensure that the project will be
   completed without any deviations from the project
   requirements. Which of the following processes are
   you performing?
A. Quality control
B. Quality planning
C. Quality assurance
D. Conduct procurements
Sample Questions

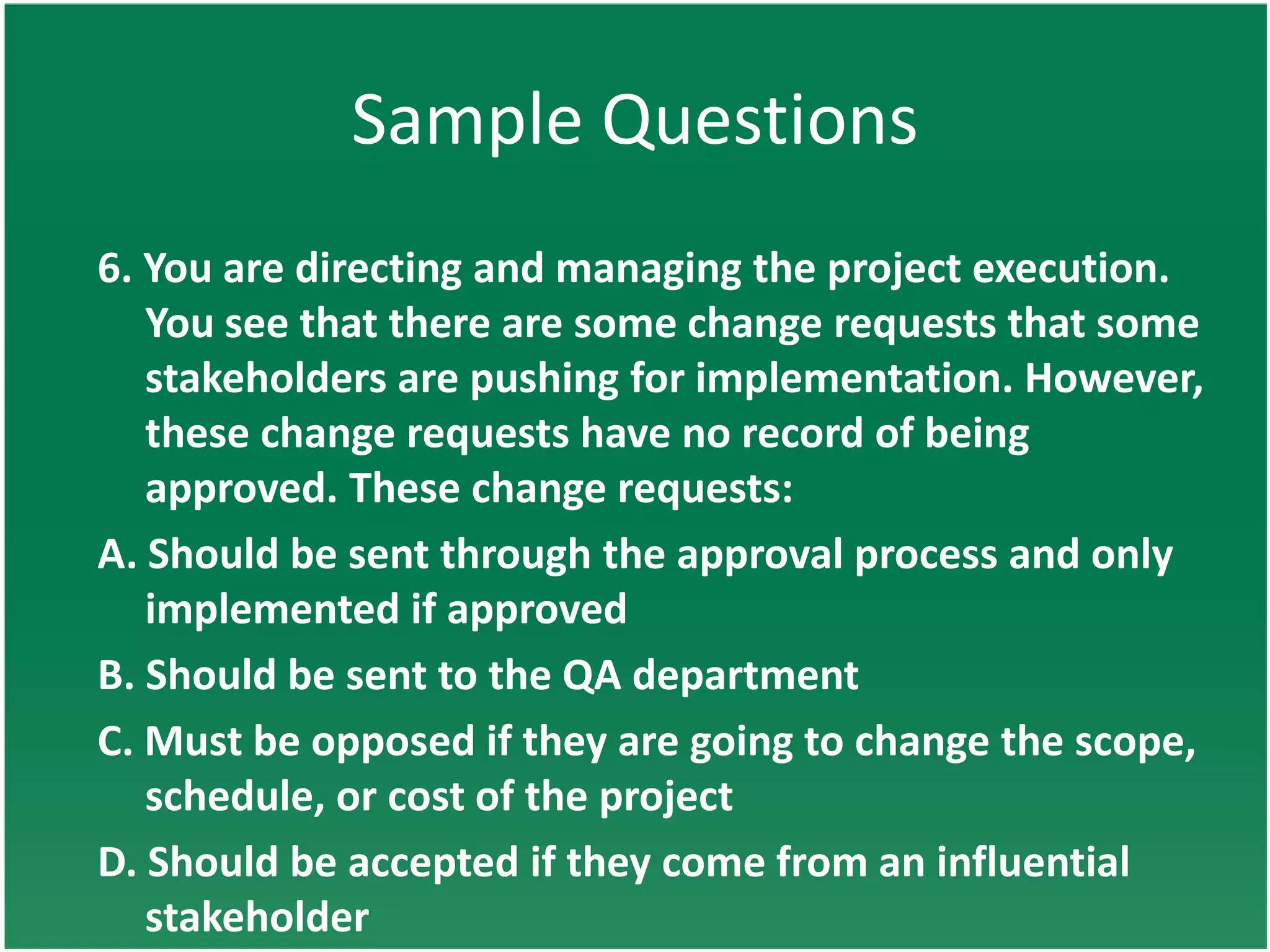

6. You are directing and managing the project execution.
   You see that there are some change requests that some
   stakeholders are pushing for implementation. However,
   these change requests have no record of being
   approved. These change requests:
A. Should be sent through the approval process and only
   implemented if approved
B. Should be sent to the QA department
C. Must be opposed if they are going to change the scope,
   schedule, or cost of the project
D. Should be accepted if they come from an influential
   stakeholder
Sample Questions

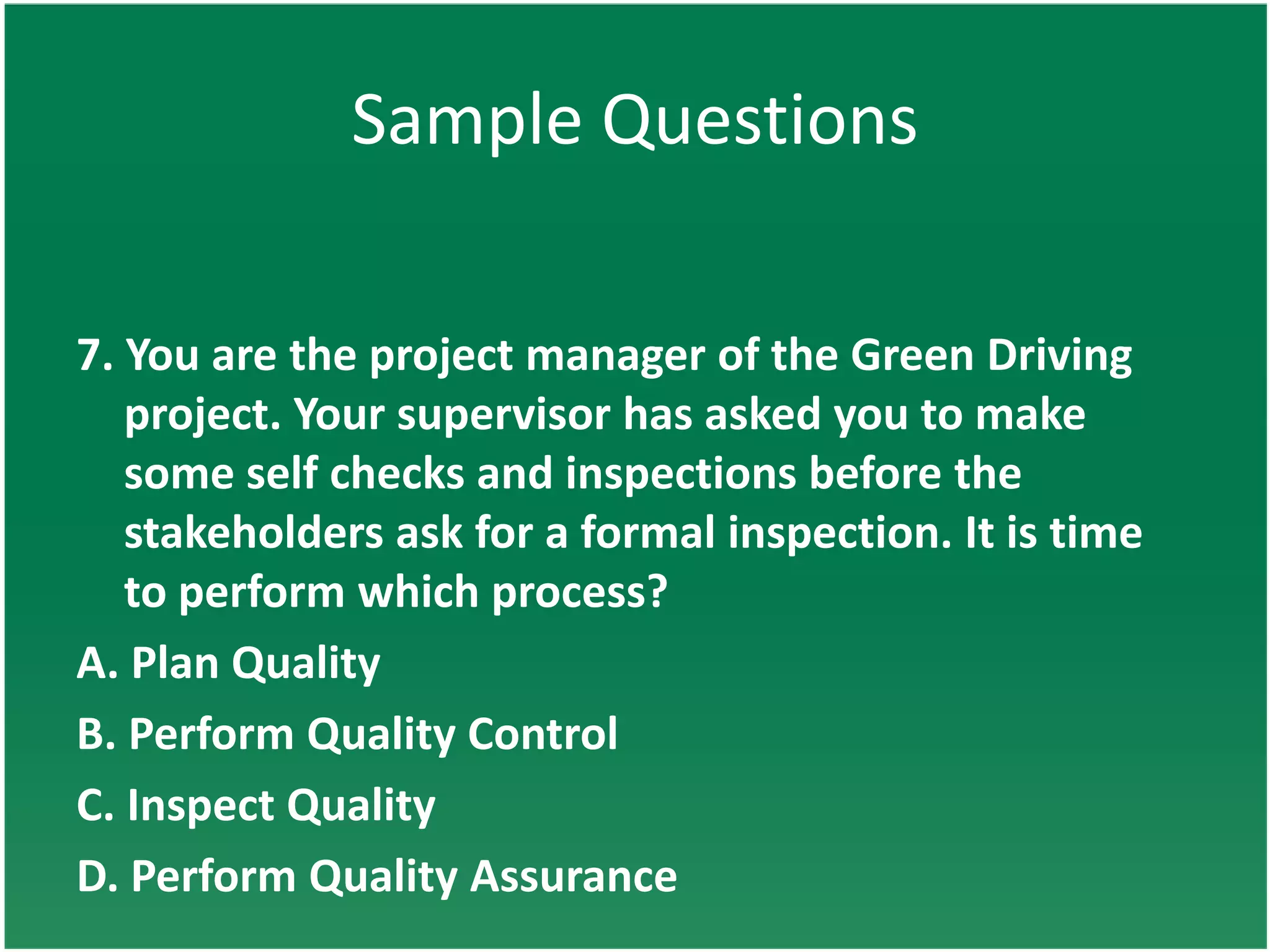

7. You are the project manager of the Green Driving
   project. Your supervisor has asked you to make
   some self checks and inspections before the
   stakeholders ask for a formal inspection. It is time
   to perform which process?
A. Plan Quality
B. Perform Quality Control
C. Inspect Quality
D. Perform Quality Assurance
Sample Questions

8. Quality audits are part of which of the following
   quality management processes?
A. Quality assurance
B. Quality control
C. Quality planning
D. Quality inspection
Sample Questions

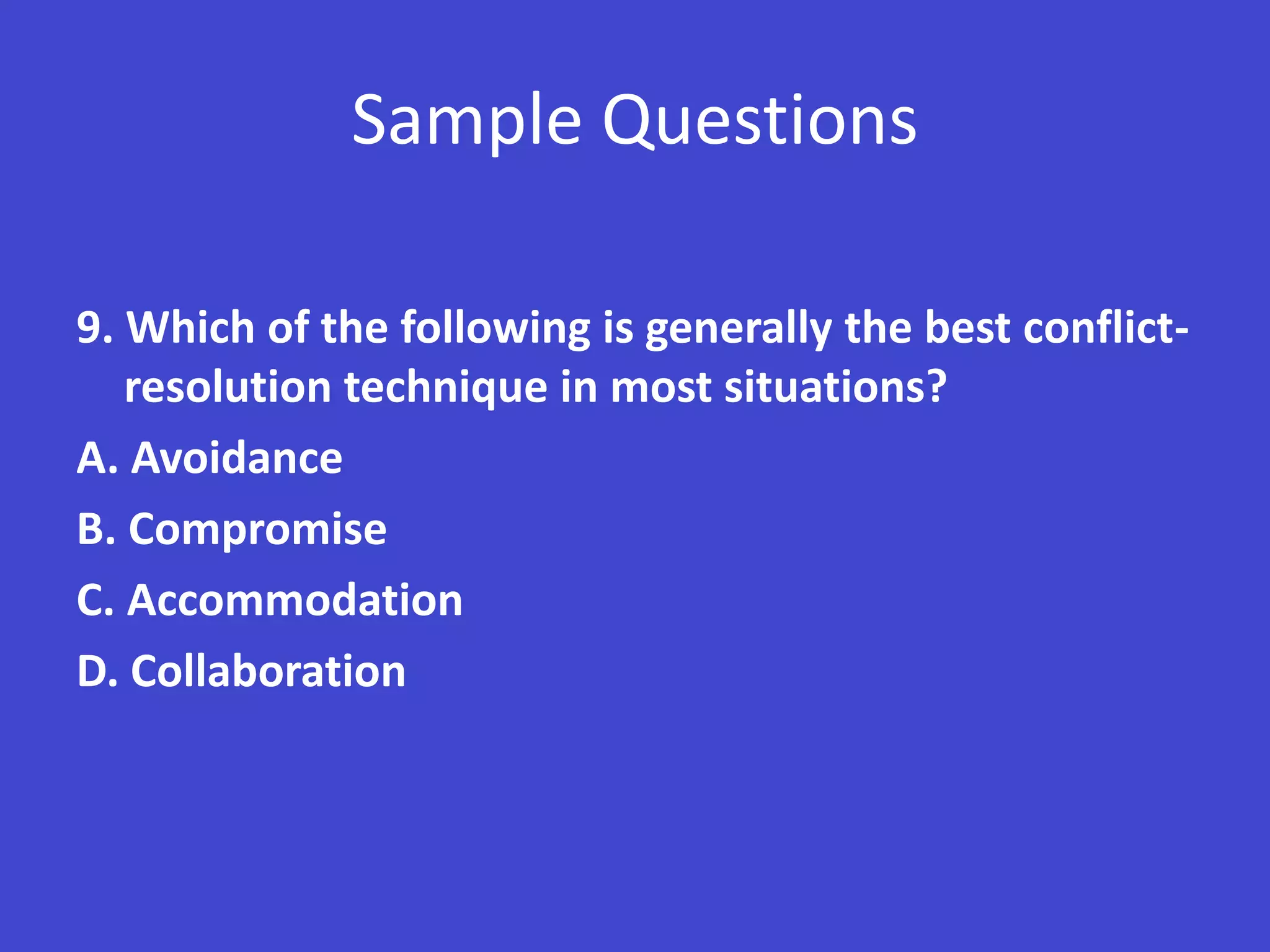

9. Which of the following is generally the best conflict-
   resolution technique in most situations?
A. Avoidance
B. Compromise
C. Accommodation
D. Collaboration
Sample Questions

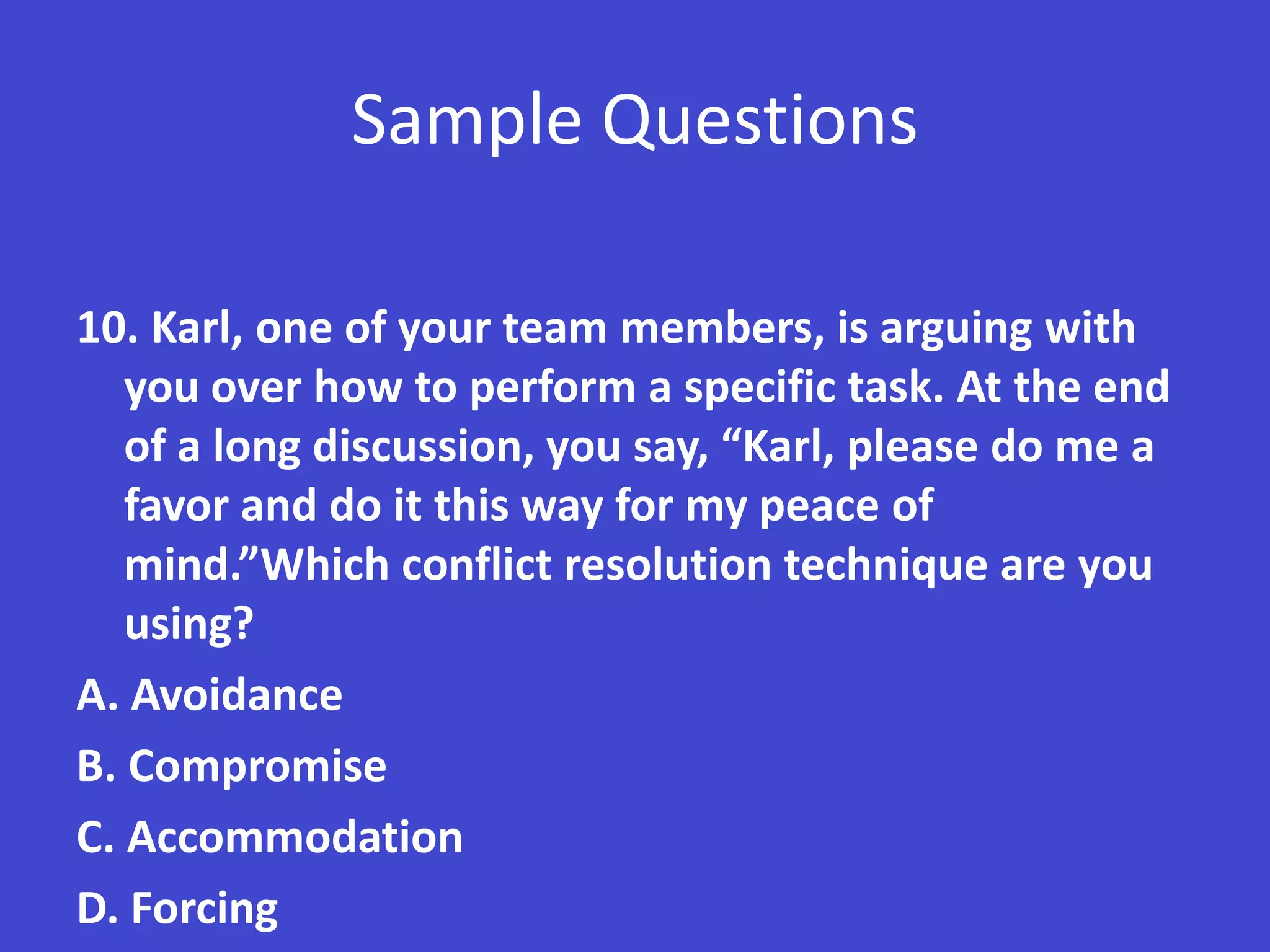

10. Karl, one of your team members, is arguing with
   you over how to perform a specific task. At the end
   of a long discussion, you say, “Karl, please do me a
   favor and do it this way for my peace of
   mind.”Which conflict resolution technique are you
   using?
A. Avoidance
B. Compromise
C. Accommodation
D. Forcing
Sample Questions

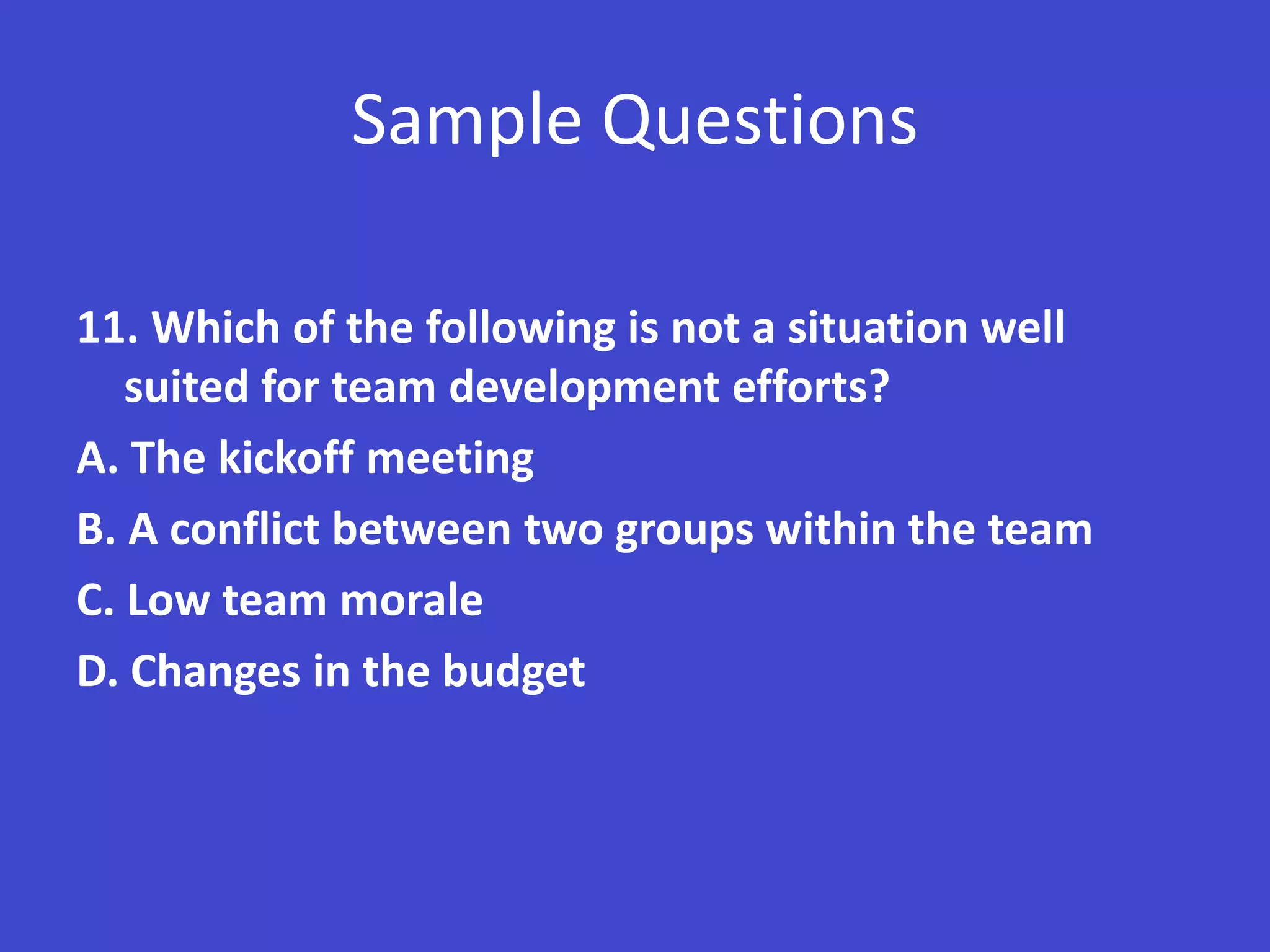

11. Which of the following is not a situation well
   suited for team development efforts?
A. The kickoff meeting
B. A conflict between two groups within the team
C. Low team morale
D. Changes in the budget
Sample Questions

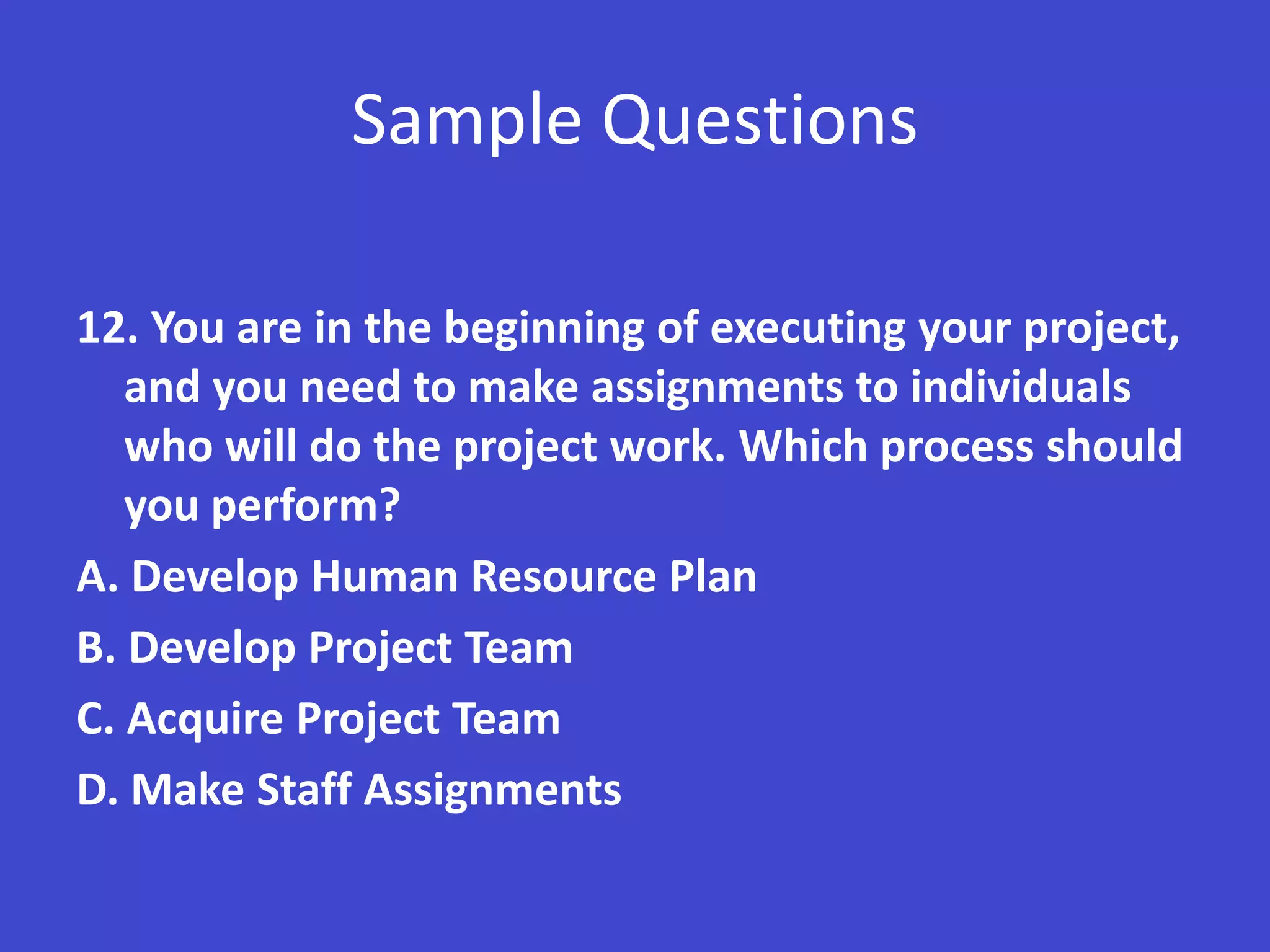

12. You are in the beginning of executing your project,
   and you need to make assignments to individuals
   who will do the project work. Which process should
   you perform?
A. Develop Human Resource Plan
B. Develop Project Team
C. Acquire Project Team
D. Make Staff Assignments
Sample Questions

13. Virtual teams are a tool and technique used in
   which of the following processes?
A. Develop Human Resource Plan
B. Develop Project Team
C. Acquire Project Team
D. Manage Project Team
Sample Questions

14. You heard in the hallway that the project manager
   of The Da Vinci Code project, named Pappu Gloria,
   has very poor soft skills. If this is true, Pappu Gloria
   needs to improve his:
A. Software skills
B. Interpersonal skills
C. Ways of handling equipment
D. Capability to use scheduling software
Sample Questions

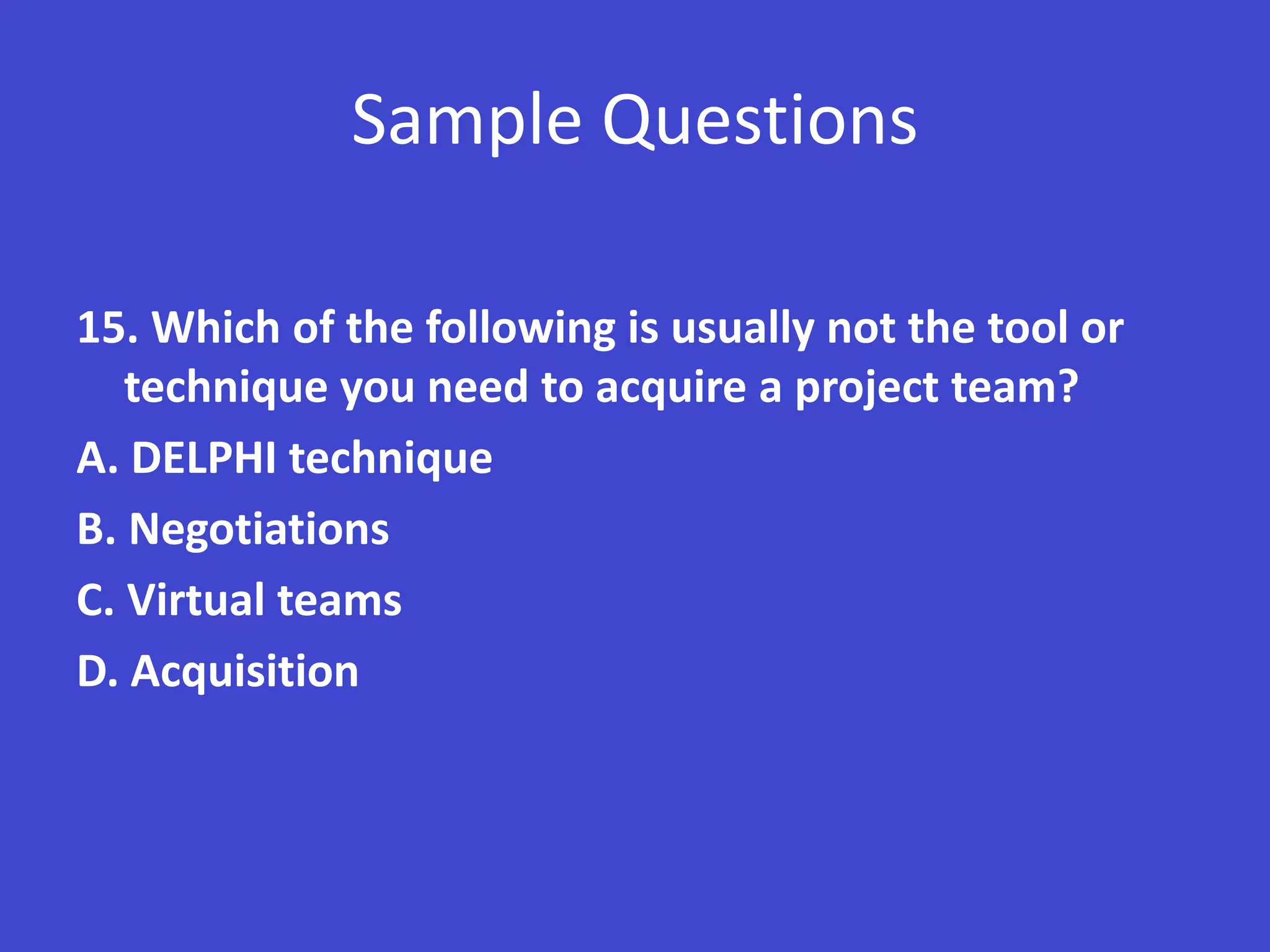

15. Which of the following is usually not the tool or
   technique you need to acquire a project team?
A. DELPHI technique
B. Negotiations
C. Virtual teams
D. Acquisition
Sample Questions

16. Shilpa Bedi, the engineering manager, receives daily
   progress reports from all the engineers she manages. She
   also visits the cubicles of the engineers several times a day
   to ensure that they are working and not just browsing the
   web. Most of the engineers agree that she is a
   micromanager. What kind of management theory is she
   applying?
A. Theory Alpha
B. Theory X
C. Theory Y
D. McClelland’s achievement motivation theory
Sample Questions

17. Gary Travis, the engineering manager, receives
   weekly progress reports from all engineers he
   manages. He encourages them to take ownership of
   their assignments. Most of the engineers agree that
   he trusts his engineers. What kind of management
   theory is he applying?
A. Theory Alpha
B. Theory X
C. Theory Y
D. McClelland’s achievement motivation theory
Sample Questions

18. Lois Travis, the project manager, receives weekly progress reports from
    all engineers she manages. She rewards the achievements of her
    employees and always gives the credit to her employees for their
    accomplishments. She is always interested in mentoring her team
    members and putting them on a career path. She also helps the good
    performers get the assignments and projects of their choice. What kind
    of management theory is she applying?
A. Theory Alpha
B. Theory X
C. Theory Y
D. McClelland’s achievement motivation theory

Pmp session 4

  • 1.
    PMP & CAPM ExamPreparation February 19, 2013
  • 2.
    Sessions 1. About theexam 2. Integration & Scope Management 3. Time & Cost Management 4. Quality & HR Management 5. Communication & Risk Management 6. Procurement Management
  • 3.
    Last Session Keypoint • Process groups: IPEMCC • 9 Knowledge Area: ISTiCoQuHurCoRiP • Project Integration Management – DevPC.PMP.DirManPex.MoConPW.PerICC.CloPP • Project Scope Management – CoDeWoBVCon
  • 4.
    Last Session Keypoint – cont’d • Project Time Management (DeSeReDDevCon) – Define activities – Sequence activities – Estimate activity resources – Estimate activity durations – Develop schedule – Control schedule
  • 5.
    Last Session Keypoint – cont’d • Project Cost Management (EsCDeBCon) – Estimate cost – Determine budget – Control cost
  • 6.
  • 7.
    Project Quality Management •Quality: the degree to which product characteristics fulfill requirements – Low quality: lots of bugs / defects • Grade: assigned category to products with same/similar functional use but different in technical characteristics – Low grade: limited features • Low quality = PROBLEM
  • 8.
    Project Quality Management •Precision: values of repeated measurements have little scatter • Accuracy: measured values closed to true value • Quality management approaches by: – Deming, Juan, Crosby – TQM, Six Sigma, VoC, FMEA (failure mode and effect analysis) – Cost of Quality: total cost of all efforts related to quality throughout product lifecycle
  • 9.
    Project Quality Management •Modern quality management focuses on: – Customer satisfaction – Prevention over inspection – Continuous improvement (PDCA  by Shewhart, modified by Deming) – Management responsibility
  • 10.
  • 11.
    Project Quality Management •Plan Quality – I – Scope baseline (…) – Stakeholder register – Cost performance baseline – Schedule baseline – Risk register – EEF – OPA
  • 12.
    Project Quality Management •Plan Quality – TT – Cost-Benefit analysis • Less rework, higher productivity, lower cost, increased stakeholder satisfaction – Cost of quality • Cost of conformance  to avoid failure • Cost of non-conformance  to fix (because of failure)
  • 13.
    Project Quality Management •Plan Quality – TT (cont’d) – Cost of quality (cont’d)
  • 14.
    Project Quality Management •Plan Quality – TT (cont’d) – Control charts • Mostly used to monitor repetitive activities (manufacturing), cost/schedule variance • To determine performance stability • To answer: “Is the process variance within acceptable limits?” • Applies higher and lower control limits (+/- 3 ) • A process is considered out of control if seven consecutive points are above or below Mean
  • 15.
  • 16.
  • 17.
    Project Quality Management •Plan Quality – TT (cont’d) – Benchmarking (comparison) – Design of Experiments • Statistical method to identify factors influencing product’s variables • Can be used to determine number and type of tests, and impact of cost of quality • E.g.: experiment to combine chemical materials to produce strong adhesive material
  • 18.
    Project Quality Management •Plan Quality – TT (cont’d) – Statistical sampling – Flowcharting
  • 19.
    Project Quality Management •Plan Quality – TT (cont’d) – Proprietary quality management methodologies • Six sigma • Lean six sigma • Quality function deployment • etc
  • 20.
    Project Quality Management •Plan Quality – TT (cont’d) – Additional quality planning tools • Brainstorming • Affinity diagrams (grouping) • Force field analysis (change factors) • Nominal group techniques (brainstorming with groups) • Matrix diagram (diagramming to look for intersection between factors, causes and objectives) • Prioritization matrices (ranking)
  • 21.
    Project Quality Management •Plan Quality – O – Quality management plan – Quality metrics • Defining tolerance • Budget control • Monitor defect frequency and rate • Define availability and reliability
  • 22.
    Project Quality Management •Plan Quality – O (cont’d) – Quality checklist – Process improvement plan • Process boundaries (start/end, I/O) • Process configuration (graphical depiction of process) • Process metrics (to analyze efficiency) • Targets for improved performance – PD U
  • 23.
    Project Quality Management •Perform Quality Assurance – Process of auditing quality requirements and results from quality control measurements to ensure appropriate quality standards and operational definitions are used
  • 24.
    Project Quality Management •Perform Quality Assurance – I – PMP – Quality metrics – WPI – Quality control measurements
  • 25.
    Project Quality Management •Perform Quality Assurance – TT – Plan quality and perform quality control tools and techniques – Quality audits • Identify good/best practices being implemented • Identify all gaps • Share the good/best practices • Proactively assist implementation improvement to raise productivity • Highlight contributions of each audit in lesson learned
  • 26.
    Project Quality Management •Perform Quality Assurance – TT (cont’d) – Process analysis • Identify a problem • Discover root cause • Develop preventive actions
  • 27.
    Project Quality Management •Perform Quality Assurance – O – OPA U – CR – PMP U – PD U
  • 28.
    Project Quality Management •Perform Quality Control – Process of monitoring and recording results of executing the quality activities to assess performance and recommend necessary changes – Performed throughout the project – The QC team must know the concept of: • Prevention and Inspection • Attribute sampling and variable sampling • Tolerance and control limit
  • 29.
    Project Quality Management •Perform Quality Control
  • 30.
    Project Quality Management •Perform Quality Control – I – PMP – Quality metrics – Quality checklist – WPM – Approved CR – Deliverables – OPA
  • 31.
    Project Quality Management •Perform Quality Control – TT – Cause and effect diagrams • AKA: ishikawa or fishbone diagrams • Asking: Why or How  Why why and How how
  • 32.
    Project Quality Management •Perform Quality Control – TT (cont’d) – Control charts – Flowcharting – Histogram • To show occurrence / frequency of variables
  • 33.
    Project Quality Management •Perform Quality Control – TT (cont’d) – Pareto chart • A histogram ordered by frequency of occurrence • Applies rank ordering to focus on corrective actions • Developed conceptually to Pareto’s law: 80/20 principle where 80% of problems are due to 20% of causes
  • 34.
    Project Quality Management •Perform Quality Control – TT (cont’d) – Run chart • Similar to control chart but no limits • Shows history and pattern of variation • Is a form of a line graph plotted in order in which they occur • Shows trend
  • 35.
    Project Quality Management •Perform Quality Control – TT (cont’d) – Scatter diagram • Shows relationship of 2 variables • To identify relationship between changes of 2 variables • The closer the points are to diagonal line, the more closely they are related
  • 36.
    Project Quality Management •Perform Quality Control – TT (cont’d) – Statistical sampling – Inspection – Approved CR review
  • 37.
    Project Quality Management •Perform Quality Control – O – Quality control measurements – Validated changes – Validated variables – OPA U – CR – PMP U – PD U
  • 38.
  • 39.
  • 40.
    Project HR Management •Develop HR Plan – I – Activity resources requirements – EEF – OPA
  • 41.
    Project HR Management •Develop HR Plan – TT – Organization charts position descriptions: • Hierarchical: organizational structure • Matrix based: RACI matrix • Text oriented • Others
  • 42.
    Project HR Management •Develop HR Plan – TT (cont’d) – Organization charts position descriptions:
  • 43.
    Project HR Management •Develop HR Plan – TT (cont’d) – Networking – Organizational theory
  • 44.
    Project HR Management •Develop HR Plan – O – HR Plan • Roles and responsibilities • Project organization charts • Staffing management plan – Staff acquisition – Resource calendar – Staff release plan – Training needs – Recognition and rewards – Compliance – Safety
  • 45.
    Project HR Management •Acquire Project Team
  • 46.
    Project HR Management •Acquire Project Team – I – PMP – EEF – OPA
  • 47.
    Project HR Management •Acquire Project Team – TT – Pre-assignment – Negotiation – Acquisition – Virtual teams  highlight the communication issues • Different geographic area • Office and mobile office staffs • Staffs with limitations / disability
  • 48.
    Project HR Management •Acquire Project Team – O – Project staff assignments – Resource calendars – PMP U
  • 49.
    Project HR Management •Develop Project Team – Improve team’s competencies/skills, interaction, and overall environment to enhance project performance – Highlight about teamwork despite cultural / language differences – Highlight about team’s bond and trust to raise morale and lower conflict – To create a dynamic and cohesive team culture
  • 50.
    Project HR Management •Develop Project Team
  • 51.
    Project HR Management •Develop Project Team – I – Project staff assignments – PMP – Resource calendars
  • 52.
    Project HR Management •Develop Project Team – TT – Interpersonal skills (soft skills, people skills like: empathy, influence, creativity) – Training – Team-building activities • Forming (the first meet and greet) • Storming (the work initiation but not so collaborative yet) • Norming (work habit adjusted, working together) • Performing (team functions very well) • Adjourning (completes work and move on)
  • 53.
    Project HR Management •Develop Project Team – TT (cont’d) – Ground rules – Co-location – Recognition and rewards
  • 54.
    Project HR Management •Develop Project Team – O – Team performance assessments • Skills and competencies improvement plan • Reduce staff turnover • Increase team cohesiveness – EEF U
  • 55.
    Project HR Management •Manage Project Team – Tracking team’s performance – Provide feedback – Resolve issues – Optimize project performance – Emphasizes on communication, conflict management, negotiation, and leadership
  • 56.
    Project HR Management •Manage Project Team – I – Project staff assignments – PMP – Team performance assessments – Performance reports – OPA
  • 57.
    Project HR Management •Manage Project Team – TT – Observation and conversation – Project performance appraisals – Conflict management • Withdrawing /avoiding • Smoothing / accommodating • Compromising • Forcing • Collaborating • Confronting / problem solving
  • 58.
    Project HR Management •Manage Project Team – TT (cont’d) – Conflict management • Withdrawing /avoiding – Retreat from potential conflict situation • Smoothing / accommodating – Emphasizing on agreement rather than differences • Compromising – Searching of solutions to bring certain level of satisfaction to all parties • Forcing • Collaborating • Confronting / problem solving
  • 59.
    Project HR Management •Manage Project Team – TT (cont’d) – Conflict management (cont’d) • Forcing – Pushing one’s point of view at the expense of others (win-lose situation) • Collaborating – Gather all parties’ viewpoints, reach consensus and commitment • Confronting / problem solving – Treat conflict as problem to be solved by examining alternatives; requires a give-and-take attitude and open dialogue
  • 60.
    Project HR Management •Manage Project Team – TT (cont’d) – Issue log – Interpersonal skills • Leadership • Influencing (persuasive and considerate) • Listening skills • Effective decision making
  • 61.
    Project HR Management •Manage Project Team – O – EEF U – OPA U – CR – PMP U
  • 62.
    Project HR Management •Motivating your team – Maslow’s hierarchy of needs • People have layers of needs • Fill the lower layer first before filling the upper layer
  • 63.
    Project HR Management •Motivating your team (cont’d) – Herzberg’s Motivation-Hygiene Theory • Hygiene factor – They do not bring satisfaction but prevent dissatisfaction – E.g.: level of supervision or ownership, relationship with superiors, compensation, etc • Motivating factor – Bring in / increase job satisfaction – E.g.: challenging work assignment, opportunity / career advancement, recognition, etc
  • 64.
    Project HR Management •Motivating your team (cont’d) – McClelland’s Achievement Motivation Theory • Achievement – The need to perform well, achieve success, and get recognized • Affiliation – Good relationship at work, feel connected at work • Power – Power to influence people or events
  • 65.
    Project HR Management •Motivating your team (cont’d) – McGregor’s X-Y Theory • Theory X – Believes most people are self-centered – Believes people are motivated by their physiological and safety needs, indifferent to organization they work for, lack ambition, have little creativity, and low problem solving capacity – Appears dislike their work and will try to avoid it; also avoid responsibility and initiative – Distrusts their employees  authoritarian
  • 66.
    Project HR Management •Motivating your team (cont’d) – McGregor’s X-Y Theory • Theory Y – Trusts their employees – Believes people are discipline, high performers, committed to meet organization’s needs they work for, like to take responsibility and high initiative – Tends to provide more freedom and opportunity for career growth
  • 67.
    Project HR Management •Motivating your team (cont’d) – Expectancy Theory • “What’s in it for me?” • Desires objective that matched with effort and rewards
  • 68.
    Sample Questions 1. Whatis the name of a quality planning technique that involves comparing the results of similar activities? A. Brainstorming B. Benchmarking C. Cost/benefit analysis D. Quality metrics
  • 69.
    Sample Questions 2. Theplan-do-check-act cycle of quality management was: A. Defined by Shewhart and modified by Deming. B. Originally defined by Deming and then modified by Shewhart. C. Defined by Crosby and modified by Deming. D. Defined by Crosby and modified by Juan.
  • 70.
    Sample Questions 3. Oneof the fundamental tenets of modern quality management is: A. Inspect the quality and then build it in. B. There is no need to design and build in the quality until you do the inspection, if it’s needed. C. Break all rules: Deliver the product in a timely fashion and then work on the quality. D. Plan, design, and build in quality as opposed to inspecting it in.
  • 71.
    Sample Questions 4. Whichof the following is not the input to the QA process? A. Quality metrics B. Quality control measurements C. Work performance information D. Recommended corrective actions
  • 72.
    Sample Questions 5. Youare the project manager for the ABC project. You are going to meet with your project team to discuss how to ensure that the project will be completed without any deviations from the project requirements. Which of the following processes are you performing? A. Quality control B. Quality planning C. Quality assurance D. Conduct procurements
  • 73.
    Sample Questions 6. Youare directing and managing the project execution. You see that there are some change requests that some stakeholders are pushing for implementation. However, these change requests have no record of being approved. These change requests: A. Should be sent through the approval process and only implemented if approved B. Should be sent to the QA department C. Must be opposed if they are going to change the scope, schedule, or cost of the project D. Should be accepted if they come from an influential stakeholder
  • 74.
    Sample Questions 7. Youare the project manager of the Green Driving project. Your supervisor has asked you to make some self checks and inspections before the stakeholders ask for a formal inspection. It is time to perform which process? A. Plan Quality B. Perform Quality Control C. Inspect Quality D. Perform Quality Assurance
  • 75.
    Sample Questions 8. Qualityaudits are part of which of the following quality management processes? A. Quality assurance B. Quality control C. Quality planning D. Quality inspection
  • 76.
    Sample Questions 9. Whichof the following is generally the best conflict- resolution technique in most situations? A. Avoidance B. Compromise C. Accommodation D. Collaboration
  • 77.
    Sample Questions 10. Karl,one of your team members, is arguing with you over how to perform a specific task. At the end of a long discussion, you say, “Karl, please do me a favor and do it this way for my peace of mind.”Which conflict resolution technique are you using? A. Avoidance B. Compromise C. Accommodation D. Forcing
  • 78.
    Sample Questions 11. Whichof the following is not a situation well suited for team development efforts? A. The kickoff meeting B. A conflict between two groups within the team C. Low team morale D. Changes in the budget
  • 79.
    Sample Questions 12. Youare in the beginning of executing your project, and you need to make assignments to individuals who will do the project work. Which process should you perform? A. Develop Human Resource Plan B. Develop Project Team C. Acquire Project Team D. Make Staff Assignments
  • 80.
    Sample Questions 13. Virtualteams are a tool and technique used in which of the following processes? A. Develop Human Resource Plan B. Develop Project Team C. Acquire Project Team D. Manage Project Team
  • 81.
    Sample Questions 14. Youheard in the hallway that the project manager of The Da Vinci Code project, named Pappu Gloria, has very poor soft skills. If this is true, Pappu Gloria needs to improve his: A. Software skills B. Interpersonal skills C. Ways of handling equipment D. Capability to use scheduling software
  • 82.
    Sample Questions 15. Whichof the following is usually not the tool or technique you need to acquire a project team? A. DELPHI technique B. Negotiations C. Virtual teams D. Acquisition
  • 83.
    Sample Questions 16. ShilpaBedi, the engineering manager, receives daily progress reports from all the engineers she manages. She also visits the cubicles of the engineers several times a day to ensure that they are working and not just browsing the web. Most of the engineers agree that she is a micromanager. What kind of management theory is she applying? A. Theory Alpha B. Theory X C. Theory Y D. McClelland’s achievement motivation theory
  • 84.
    Sample Questions 17. GaryTravis, the engineering manager, receives weekly progress reports from all engineers he manages. He encourages them to take ownership of their assignments. Most of the engineers agree that he trusts his engineers. What kind of management theory is he applying? A. Theory Alpha B. Theory X C. Theory Y D. McClelland’s achievement motivation theory
  • 85.
    Sample Questions 18. LoisTravis, the project manager, receives weekly progress reports from all engineers she manages. She rewards the achievements of her employees and always gives the credit to her employees for their accomplishments. She is always interested in mentoring her team members and putting them on a career path. She also helps the good performers get the assignments and projects of their choice. What kind of management theory is she applying? A. Theory Alpha B. Theory X C. Theory Y D. McClelland’s achievement motivation theory
