1
Risk Management
Project Management
Session 10
Dr. M. Sepehri
FAll 1390
2

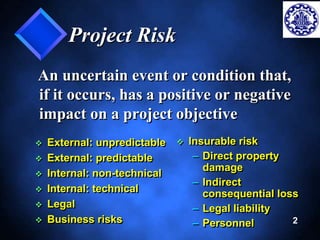

Project Risk
An uncertain event or condition that,
if it occurs, has a positive or negative
impact on a project objective
 External: unpredictable
 External: predictable
 Internal: non-technical
 Internal: technical
 Legal
 Business risks
 Insurable risk
– Direct property
damage
– Indirect
consequential loss
– Legal liability
– Personnel
3

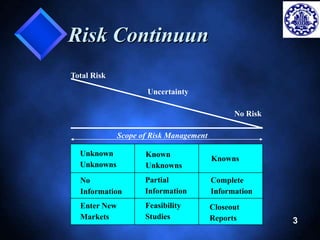

Risk Continuun
Unknown
Unknowns
Known
Unknowns
Knowns
No
Information
Partial
Information
Complete
Information
Total Risk
Uncertainty
No Risk
Scope of Risk Management
Feasibility
Studies
Closeout
Reports
Enter New
Markets
4

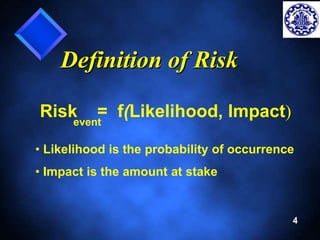

Definition of Risk
Risk = f(Likelihood, Impact)
event
• Likelihood is the probability of occurrence
• Impact is the amount at stake
5

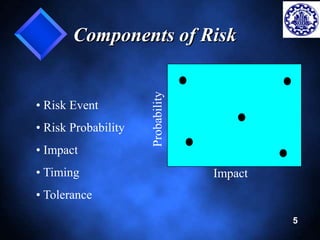

Components of Risk
Impact
Probability
• Risk Event
• Risk Probability
• Impact
• Timing
• Tolerance
6
7

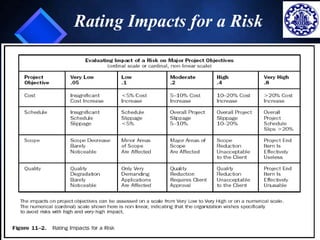

Rating Impacts for a Risk
8
9

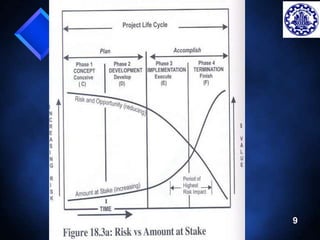

10
Variation through the
Project Life Cycle?
Time along project life cycle
Familiarity
Mitigation?
Risk Event
Probability?
Amount to
complete?
Amount
at Stake?
Cost to make
Changes?
11
RISK MANAGEMENT
Why bother with Risk Management?
Arguments AGAINST


Arguments FOR


12

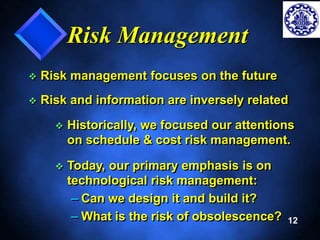

Risk Management
 Risk management focuses on the future
 Risk and information are inversely related
 Historically, we focused our attentions
on schedule & cost risk management.
 Today, our primary emphasis is on
technological risk management:
– Can we design it and build it?
– What is the risk of obsolescence?

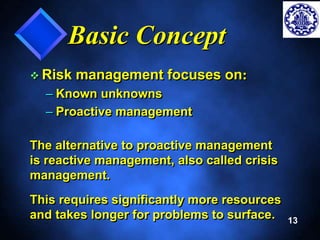

13
Basic Concept
 Risk management focuses on:
– Known unknowns
– Proactive management
The alternative to proactive management
is reactive management, also called crisis
management.
This requires significantly more resources
and takes longer for problems to surface.
14
Preparing for Possibilities
15

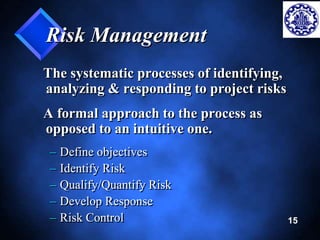

Risk Management
The systematic processes of identifying,
analyzing & responding to project risks
A formal approach to the process as
opposed to an intuitive one.
– Define objectives
– Identify Risk
– Qualify/Quantify Risk
– Develop Response
– Risk Control

رابطه بين مراحل مديريت پروژه با مديريت ريسك
16
پروژه
17

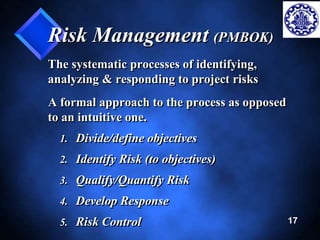

Risk Management (PMBOK)
The systematic processes of identifying,
analyzing & responding to project risks
A formal approach to the process as opposed
to an intuitive one.
1. Divide/define objectives
2. Identify Risk (to objectives)
3. Qualify/Quantify Risk
4. Develop Response
5. Risk Control
18

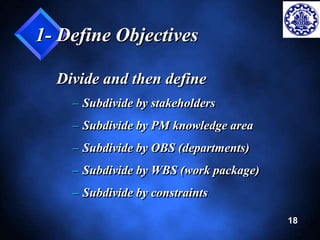

1- Define Objectives
Divide and then define
– Subdivide by stakeholders
– Subdivide by PM knowledge area
– Subdivide by OBS (departments)
– Subdivide by WBS (work package)
– Subdivide by constraints

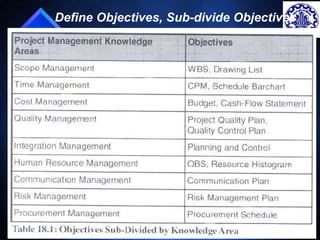

Define Objectives, Sub-divide Objectives
19

20
21

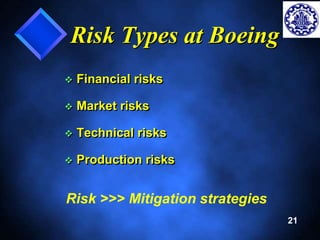

Risk Types at Boeing
 Financial risks
 Market risks
 Technical risks
 Production risks
Risk >>> Mitigation strategies
22
Financial Risks
 Up-front funding and payback period
based upon number of planes sold
– Mitigation strategies
 Funding by life cycle phase
 Continuous financial risk
management
 Sharing risks with subcontractors
 Risk reevaluation based upon sales
commitments
23
Market Risks
 Forecasting customers’ expectations on
cost, configuration, and amenities based
upon a 30-40 year life of a plane
– Mitigation strategies
Close customer contact and input
Willingness to custom-design per
customer
Development of a baseline design
that allows for customization
24
Technical Risks
 Because of the long lifetime for a plane, we
must forecast technology and its impact on
cost, safety, reliability and maintainability
– Mitigation strategies
structured change management process
Use of proven technology rather than
high risk technology
Parallel product improvement and new
product development processes
25

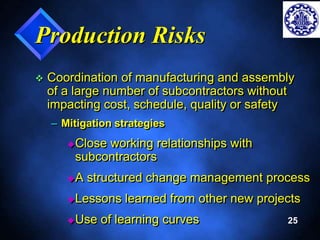

Production Risks
 Coordination of manufacturing and assembly
of a large number of subcontractors without
impacting cost, schedule, quality or safety
– Mitigation strategies
Close working relationships with
subcontractors
A structured change management process
Lessons learned from other new projects
Use of learning curves
26
27

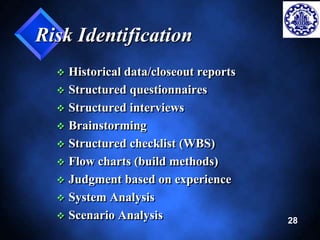

2- Risk Identification
Start with each objective
•Cause to effect
•Effect caused by
28
Risk Identification
 Historical data/closeout reports
 Structured questionnaires
 Structured interviews
 Brainstorming
 Structured checklist (WBS)
 Flow charts (build methods)
 Judgment based on experience
 System Analysis
 Scenario Analysis
29
Why Projects Fail
 Innovation
 Concurrency
 Stakeholders
 Communication
 Scope of work
 Poor estimating
 Poor planning
 Insufficient reviews
 Insufficient control
 Lack of commitment
 Incomplete and/or in-accurate
information
 Lack of support
from team members
 . . . .
30

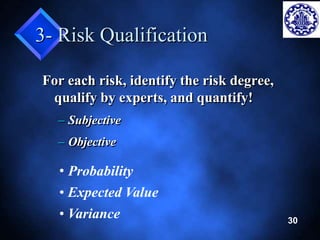

3- Risk Qualification
For each risk, identify the risk degree,
qualify by experts, and quantify!
– Subjective
– Objective
• Probability
• Expected Value
• Variance
31

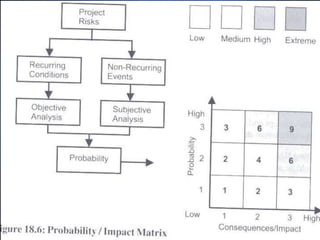

32
Consequence, Priority
33
4- Risk Response
• Eliminate Risk
Remove early
• Mitigate Risk
Reduce probability/impact
• Deflect Risk
Transfer to another party
• Accept Risk
 Avoidance
 Control (mitigation)
 Transfer
 Assumption (retention)

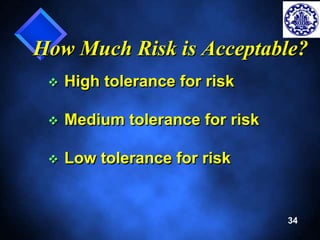

How Much Risk is Acceptable?
34
 High tolerance for risk
 Medium tolerance for risk
 Low tolerance for risk
35

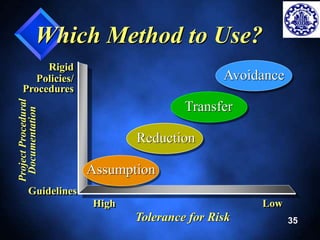

Which Method to Use?
Project Procedural
Documentation
Guidelines
Reduction
Avoidance
High Low
Tolerance for Risk
Rigid
Policies/
Procedures
Assumption
Transfer
Developing Contingency Plans
36
37
Problem-Solving
Idea Generation:
Brainstorming
38
5- Risk Control
Implements Risk Management plan to make it
happen. Most neglected, but most important.
Includes communication, training, practice
runs. Develop company culture & attitude.
Risk Management plan is monitored/updated on
a regular basis to include any changes:
– Changes in the scope of work
– Changes in the build method
– Changes in the team members
– Changes in the suppliers
39

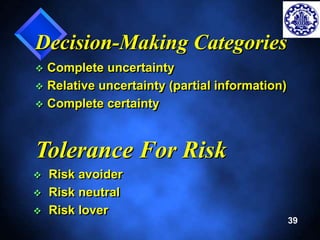

Decision-Making Categories
 Complete uncertainty
 Relative uncertainty (partial information)
 Complete certainty
Tolerance For Risk
 Risk avoider
 Risk neutral
 Risk lover
40

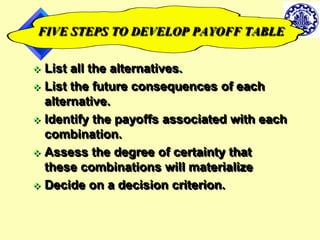

FIVE STEPS TO DEVELOP PAYOFF TABLE
 List all the alternatives.
 List the future consequences of each
alternative.
 Identify the payoffs associated with each
combination.
 Assess the degree of certainty that
these combinations will materialize
 Decide on a decision criterion.
41

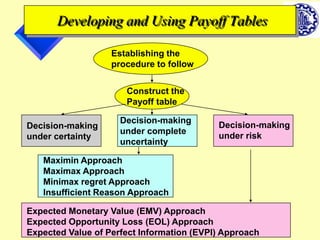

Developing and Using Payoff Tables
Establishing the
procedure to follow
Construct the
Payoff table
Decision-making
under certainty
Decision-making
under complete
uncertainty
Maximin Approach
Maximax Approach
Minimax regret Approach
Insufficient Reason Approach
Decision-making
under risk
Expected Monetary Value (EMV) Approach
Expected Opportunity Loss (EOL) Approach
Expected Value of Perfect Information (EVPI) Approach
LEGEND
42

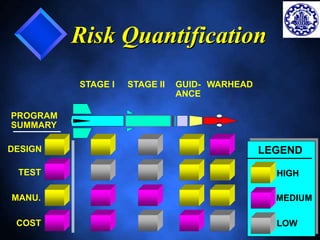

Risk Quantification
STAGE I STAGE II GUID-ANCE
WARHEAD
DESIGN
TEST
MANU.
COST
HIGH
MEDIUM
LOW
PROGRAM
SUMMARY
43

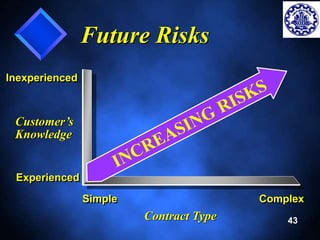

Future Risks
Inexperienced
Customer’s
Knowledge
Experienced
Simple Complex
Contract Type
Degrees of Downstream Risk

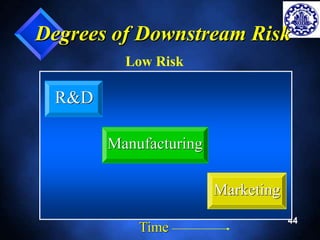

44

R&D
Low Risk
Manufacturing
Marketing
Time
Degrees of Downstream Risk
45
R&D
High Risk
Manufacturing
Marketing
Time
46
Prioritization of Risks
Schedule Cost
Technical
Performance
or Quality
First
(Highest)
Priority
Second
Priority
Third
Priority
47

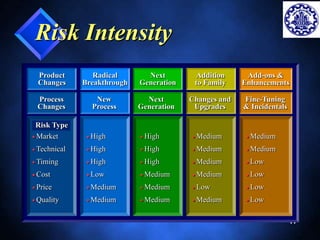

Risk Intensity
Radical
Breakthrough
Product
Changes
Next
Generation
Add-ons &
Enhancements
Addition
to Family
New
Process
Process
Changes
Next
Generation
Fine-Tuning
& Incidentals
Changes and
Upgrades
Risk Type
 Market
 Technical
 Timing
 Cost
 Price
Quality
High
High
High
 Low
 Medium
 Medium
High
High
High
 Medium
 Medium
 Medium
 Medium
 Medium
 Medium
 Medium
 Low
 Medium
 Medium
 Medium
 Low
 Low
 Low
 Low
48
Risk Control Measures
Extreme
Intensity of Controls
Risk Intensity
Standard
Controls
High
Range of Controls
Low
Low
49

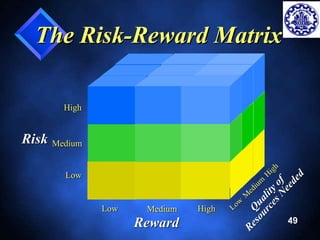

The Risk-Reward Matrix
Low High
Medium
Reward
Risk
High
Medium
Low
50
Interacting Risks
Specification Limit
On Characteristic B
Product Feature A
Product Feature B
Desirable
Undesirable
Undesirable Desirable

51
Poor Risk
Management
Risk Planning
Technical
Inability
Performance
Time
52
You never know

Pm session10

  • 1.
    1 Risk Management Project Management Session 10 Dr. M. Sepehri FAll 1390
  • 2.
    2 Project Risk An uncertain event or condition that, if it occurs, has a positive or negative impact on a project objective  External: unpredictable  External: predictable  Internal: non-technical  Internal: technical  Legal  Business risks  Insurable risk – Direct property damage – Indirect consequential loss – Legal liability – Personnel
  • 3.
    3 Risk Continuun Unknown Unknowns Known Unknowns Knowns No Information Partial Information Complete Information Total Risk Uncertainty No Risk Scope of Risk Management Feasibility Studies Closeout Reports Enter New Markets
  • 4.
    4 Definition ofRisk Risk = f(Likelihood, Impact) event • Likelihood is the probability of occurrence • Impact is the amount at stake
  • 5.
    5 Components ofRisk Impact Probability • Risk Event • Risk Probability • Impact • Timing • Tolerance
  • 6.
  • 7.
    7 Rating Impactsfor a Risk
  • 8.
  • 9.
  • 10.
    10 Variation throughthe Project Life Cycle? Time along project life cycle Familiarity Mitigation? Risk Event Probability? Amount to complete? Amount at Stake? Cost to make Changes?
  • 11.
    11 RISK MANAGEMENT Why bother with Risk Management? Arguments AGAINST   Arguments FOR  
  • 12.
    12 Risk Management  Risk management focuses on the future  Risk and information are inversely related  Historically, we focused our attentions on schedule & cost risk management.  Today, our primary emphasis is on technological risk management: – Can we design it and build it? – What is the risk of obsolescence?
  • 13.
    13 Basic Concept  Risk management focuses on: – Known unknowns – Proactive management The alternative to proactive management is reactive management, also called crisis management. This requires significantly more resources and takes longer for problems to surface.
  • 14.
    14 Preparing forPossibilities
  • 15.
    15 Risk Management The systematic processes of identifying, analyzing & responding to project risks A formal approach to the process as opposed to an intuitive one. – Define objectives – Identify Risk – Qualify/Quantify Risk – Develop Response – Risk Control
  • 16.
    رابطه بين مراحلمديريت پروژه با مديريت ريسك 16 پروژه
  • 17.
    17 Risk Management(PMBOK) The systematic processes of identifying, analyzing & responding to project risks A formal approach to the process as opposed to an intuitive one. 1. Divide/define objectives 2. Identify Risk (to objectives) 3. Qualify/Quantify Risk 4. Develop Response 5. Risk Control
  • 18.
    18 1- DefineObjectives Divide and then define – Subdivide by stakeholders – Subdivide by PM knowledge area – Subdivide by OBS (departments) – Subdivide by WBS (work package) – Subdivide by constraints
  • 19.
  • 20.
  • 21.
    21 Risk Typesat Boeing  Financial risks  Market risks  Technical risks  Production risks Risk >>> Mitigation strategies
  • 22.
    22 Financial Risks  Up-front funding and payback period based upon number of planes sold – Mitigation strategies  Funding by life cycle phase  Continuous financial risk management  Sharing risks with subcontractors  Risk reevaluation based upon sales commitments
  • 23.
    23 Market Risks  Forecasting customers’ expectations on cost, configuration, and amenities based upon a 30-40 year life of a plane – Mitigation strategies Close customer contact and input Willingness to custom-design per customer Development of a baseline design that allows for customization
  • 24.
    24 Technical Risks  Because of the long lifetime for a plane, we must forecast technology and its impact on cost, safety, reliability and maintainability – Mitigation strategies structured change management process Use of proven technology rather than high risk technology Parallel product improvement and new product development processes
  • 25.
    25 Production Risks  Coordination of manufacturing and assembly of a large number of subcontractors without impacting cost, schedule, quality or safety – Mitigation strategies Close working relationships with subcontractors A structured change management process Lessons learned from other new projects Use of learning curves
  • 26.
  • 27.
    27 2- RiskIdentification Start with each objective •Cause to effect •Effect caused by
  • 28.
    28 Risk Identification  Historical data/closeout reports  Structured questionnaires  Structured interviews  Brainstorming  Structured checklist (WBS)  Flow charts (build methods)  Judgment based on experience  System Analysis  Scenario Analysis
  • 29.
    29 Why ProjectsFail  Innovation  Concurrency  Stakeholders  Communication  Scope of work  Poor estimating  Poor planning  Insufficient reviews  Insufficient control  Lack of commitment  Incomplete and/or in-accurate information  Lack of support from team members  . . . .
  • 30.
    30 3- RiskQualification For each risk, identify the risk degree, qualify by experts, and quantify! – Subjective – Objective • Probability • Expected Value • Variance
  • 31.
  • 32.
  • 33.
    33 4- RiskResponse • Eliminate Risk Remove early • Mitigate Risk Reduce probability/impact • Deflect Risk Transfer to another party • Accept Risk  Avoidance  Control (mitigation)  Transfer  Assumption (retention)
  • 34.
    How Much Riskis Acceptable? 34  High tolerance for risk  Medium tolerance for risk  Low tolerance for risk
  • 35.
    35 Which Methodto Use? Project Procedural Documentation Guidelines Reduction Avoidance High Low Tolerance for Risk Rigid Policies/ Procedures Assumption Transfer
  • 36.
  • 37.
    37 Problem-Solving IdeaGeneration: Brainstorming
  • 38.
    38 5- RiskControl Implements Risk Management plan to make it happen. Most neglected, but most important. Includes communication, training, practice runs. Develop company culture & attitude. Risk Management plan is monitored/updated on a regular basis to include any changes: – Changes in the scope of work – Changes in the build method – Changes in the team members – Changes in the suppliers
  • 39.
    39 Decision-Making Categories  Complete uncertainty  Relative uncertainty (partial information)  Complete certainty Tolerance For Risk  Risk avoider  Risk neutral  Risk lover
  • 40.
    40 FIVE STEPSTO DEVELOP PAYOFF TABLE  List all the alternatives.  List the future consequences of each alternative.  Identify the payoffs associated with each combination.  Assess the degree of certainty that these combinations will materialize  Decide on a decision criterion.
  • 41.
    41 Developing andUsing Payoff Tables Establishing the procedure to follow Construct the Payoff table Decision-making under certainty Decision-making under complete uncertainty Maximin Approach Maximax Approach Minimax regret Approach Insufficient Reason Approach Decision-making under risk Expected Monetary Value (EMV) Approach Expected Opportunity Loss (EOL) Approach Expected Value of Perfect Information (EVPI) Approach
  • 42.
    LEGEND 42 RiskQuantification STAGE I STAGE II GUID-ANCE WARHEAD DESIGN TEST MANU. COST HIGH MEDIUM LOW PROGRAM SUMMARY
  • 43.
    43 Future Risks Inexperienced Customer’s Knowledge Experienced Simple Complex Contract Type
  • 44.
    Degrees of DownstreamRisk 44 R&D Low Risk Manufacturing Marketing Time
  • 45.
    Degrees of DownstreamRisk 45 R&D High Risk Manufacturing Marketing Time
  • 46.
    46 Prioritization ofRisks Schedule Cost Technical Performance or Quality First (Highest) Priority Second Priority Third Priority
  • 47.
    47 Risk Intensity Radical Breakthrough Product Changes Next Generation Add-ons & Enhancements Addition to Family New Process Process Changes Next Generation Fine-Tuning & Incidentals Changes and Upgrades Risk Type  Market  Technical  Timing  Cost  Price Quality High High High  Low  Medium  Medium High High High  Medium  Medium  Medium  Medium  Medium  Medium  Medium  Low  Medium  Medium  Medium  Low  Low  Low  Low
  • 48.
    48 Risk ControlMeasures Extreme Intensity of Controls Risk Intensity Standard Controls High Range of Controls Low Low
  • 49.
    49 The Risk-RewardMatrix Low High Medium Reward Risk High Medium Low
  • 50.
    50 Interacting Risks Specification Limit On Characteristic B Product Feature A Product Feature B Desirable Undesirable Undesirable Desirable
  • 51.
    51 Poor Risk Management Risk Planning Technical Inability Performance Time
  • 52.
