Risk Management
● Introduction
● Risk identification
● Risk projection (estimation)
● Risk mitigation, monitoring, and
management
)
Introduction.
*
Definition of Risk
● A risk is a potential problem – it might happen and it might not
● Conceptual definition of risk
● Risk concerns future happenings
● Risk involves change in mind, opinion, actions, places, etc.
● Risk involves choice and the uncertainty that choice entails
● Two characteristics of risk
● Uncertainty – the risk may or may not happen, that is, there are no 100%
risks (those, instead, are called constraints)
● Loss – the risk becomes a reality and unwanted consequences or losses
occur
*

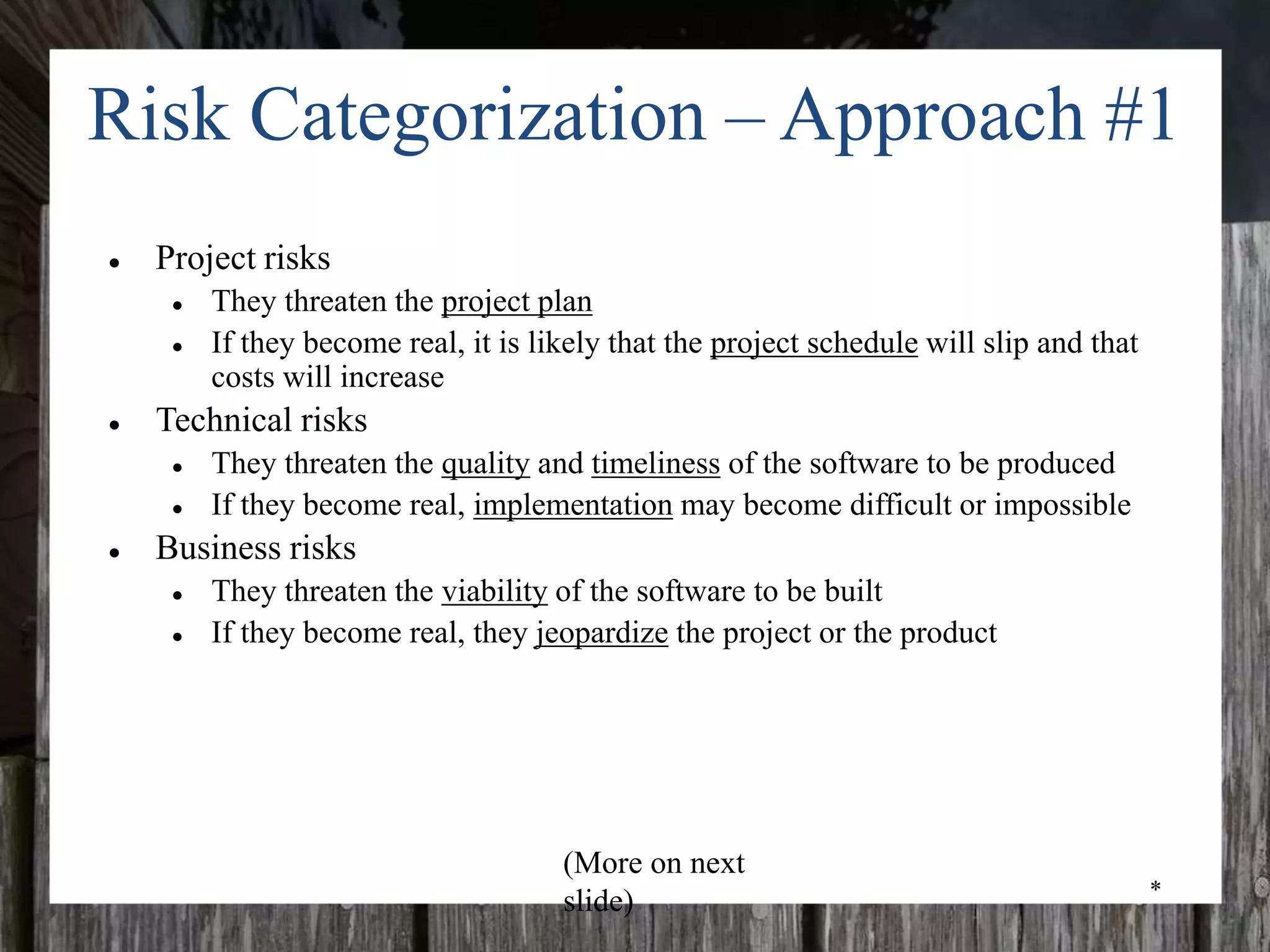

Risk Categorization – Approach #1
● Project risks
● They threaten the project plan
● If they become real, it is likely that the project schedule will slip and that
costs will increase
● Technical risks
● They threaten the quality and timeliness of the software to be produced
● If they become real, implementation may become difficult or impossible
● Business risks
● They threaten the viability of the software to be built
● If they become real, they jeopardize the project or the product
(More on next
slide)
*

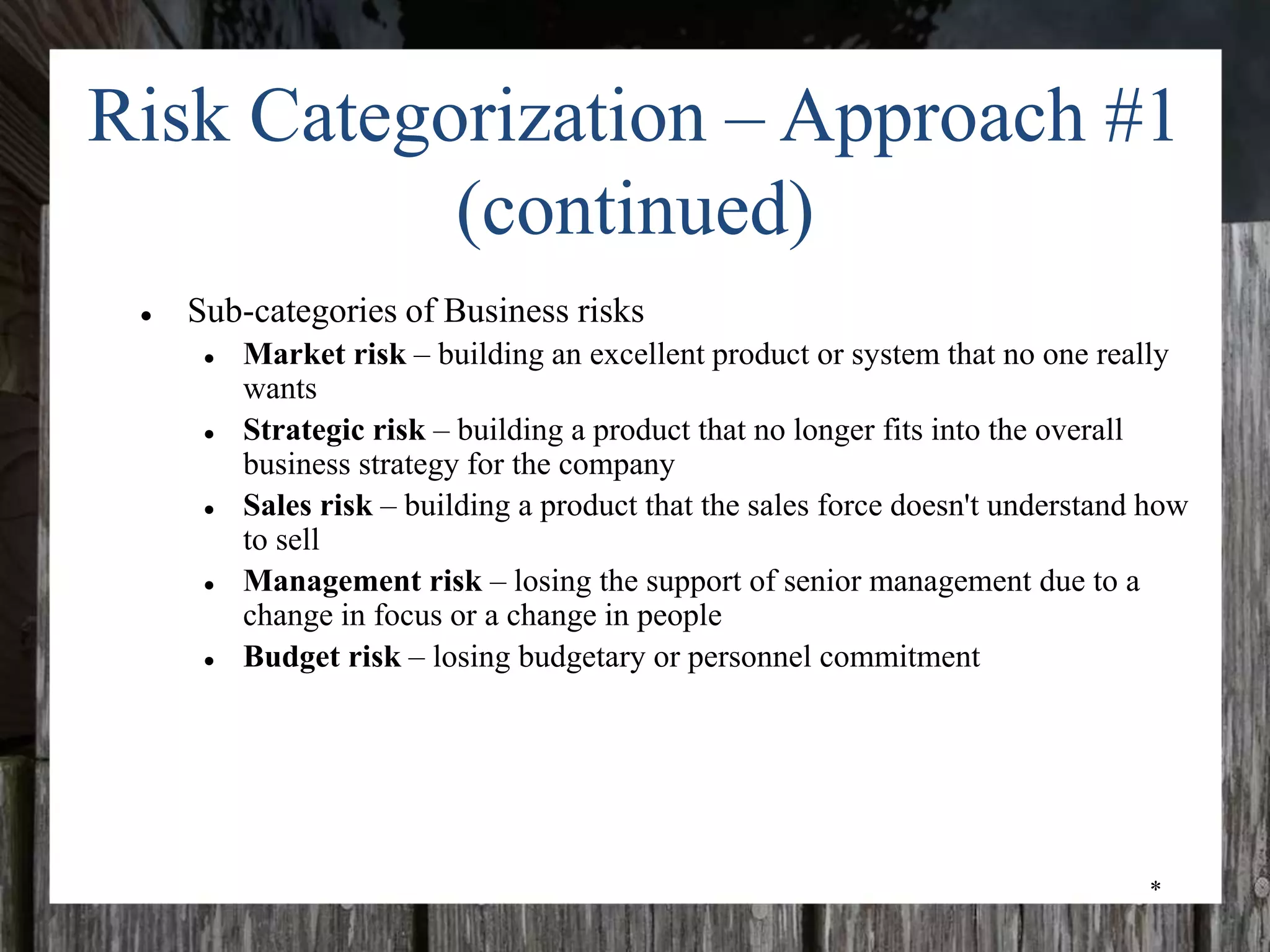

Risk Categorization – Approach #1
(continued)
● Sub-categories of Business risks
● Market risk – building an excellent product or system that no one really
wants
● Strategic risk – building a product that no longer fits into the overall
business strategy for the company
● Sales risk – building a product that the sales force doesn't understand how
to sell
● Management risk – losing the support of senior management due to a
change in focus or a change in people
● Budget risk – losing budgetary or personnel commitment
*
Risk Categorization – Approach #2
● Known risks
● Those risks that can be uncovered after careful evaluation of the project plan,
the business and technical environment in which the project is being
developed, and other reliable information sources (e.g., unrealistic delivery
date)
● Predictable risks
● Those risks that are extrapolated from past project experience (e.g., past
turnover)
● Unpredictable risks
● Those risks that can and do occur, but are extremely difficult to identify in
advance
*
Reactive vs. Proactive Risk
Strategies
● Reactive risk strategies
● "Don't worry, I'll think of something"
● The majority of software teams and managers rely on this approach
● Nothing is done about risks until something goes wrong
● The team then flies into action in an attempt to correct the problem rapidly
(fire fighting)
● Crisis management is the choice of management techniques
● Proactive risk strategies
● Steps for risk management are followed (see next slide)
● Primary objective is to avoid risk and to have a contingency plan in place
to handle unavoidable risks in a controlled and effective manner
*
Steps for Risk Management
1. Identify possible risks; recognize what can go wrong
2. Analyze each risk to estimate the probability that it will occur
and the impact (i.e., damage) that it will do if it does occur
3. Rank the risks by probability and impact
- Impact may be negligible, marginal, critical, and catastrophic
4. Develop a contingency plan to manage those risks having
high probability and high impact
Risk Identification.
*
Background
● Risk identification is a systematic attempt to specify threats to the
project plan
● By identifying known and predictable risks, the project manager takes
a first step toward avoiding them when possible and controlling them
when necessary
● Generic risks
● Risks that are a potential threat to every software project
● Product-specific risks
● Risks that can be identified only by those a with a clear understanding of
the technology, the people, and the environment that is specific to the
software that is to be built
● This requires examination of the project plan and the statement of scope
● "What special characteristics of this product may threaten our project
plan?"
*
Risk Item Checklist
● Used as one way to identify risks
● Focuses on known and predictable risks in specific subcategories (see
next slide)
● Can be organized in several ways
● A list of characteristics relevant to each risk subcategory
● Questionnaire that leads to an estimate on the impact of each risk
● A list containing a set of risk component and drivers and their probability
of occurrence
*
Known and Predictable Risk Categories
● Product size – risks associated with overall size of the software to be
built
● Business impact – risks associated with constraints imposed by
management or the marketplace
● Customer characteristics – risks associated with sophistication of the
customer and the developer's ability to communicate with the customer
in a timely manner
● Process definition – risks associated with the degree to which the
software process has been defined and is followed
● Development environment – risks associated with availability and
quality of the tools to be used to build the project
● Technology to be built – risks associated with complexity of the
system to be built and the "newness" of the technology in the system
● Staff size and experience – risks associated with overall technical and
project experience of the software engineers who will do the work
*

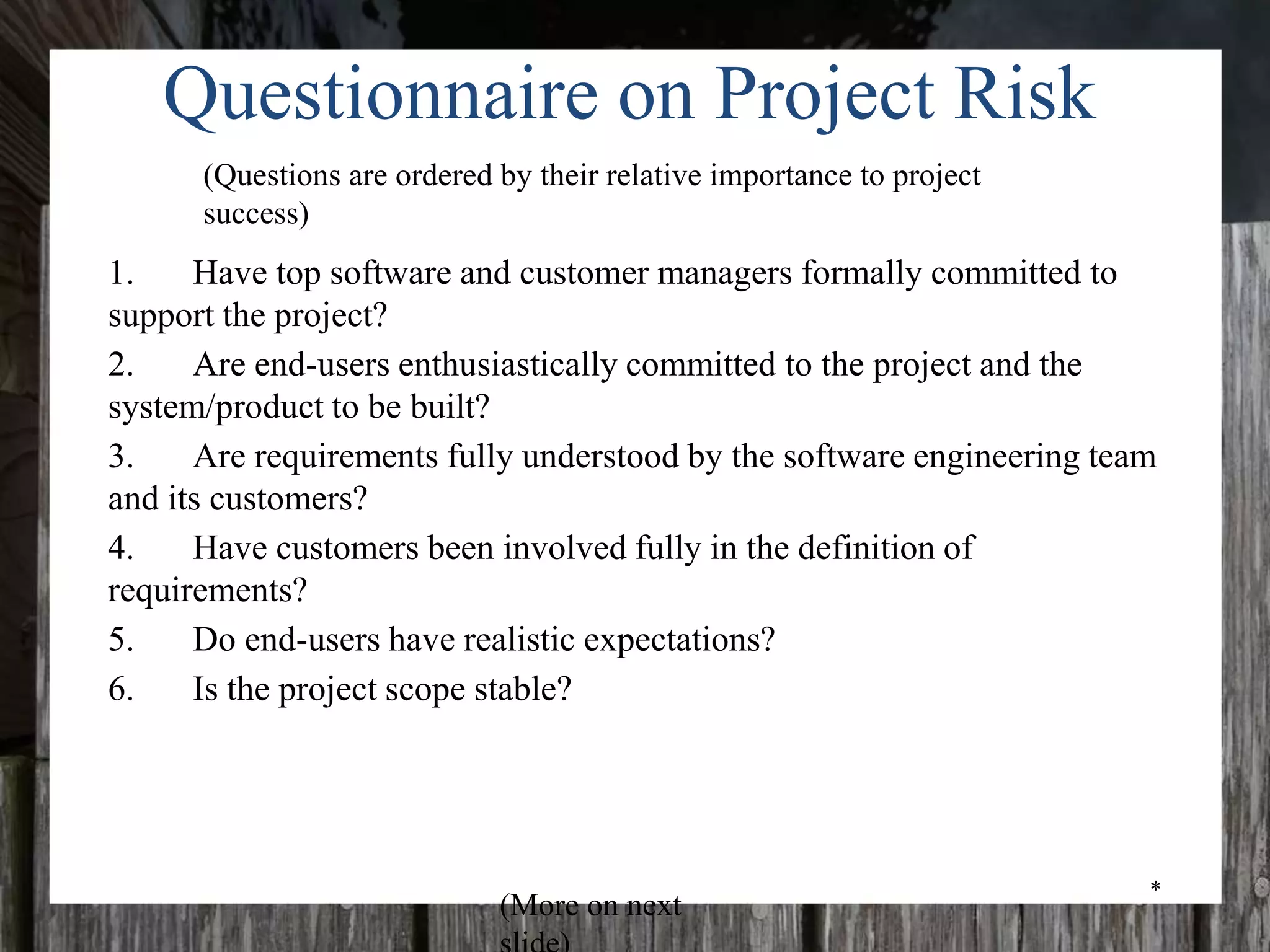

Questionnaire on Project Risk
1. Have top software and customer managers formally committed to
support the project?
2. Are end-users enthusiastically committed to the project and the
system/product to be built?
3. Are requirements fully understood by the software engineering team
and its customers?
4. Have customers been involved fully in the definition of
requirements?
5. Do end-users have realistic expectations?
6. Is the project scope stable?
(Questions are ordered by their relative importance to project
success)
(More on next
*
Questionnaire on Project Risk
(continued)
7. Does the software engineering team have the right mix of skills?
8. Are project requirements stable?
9. Does the project team have experience with the technology to be
implemented?
10. Is the number of people on the project team adequate to do the job?
11. Do all customer/user constituencies agree on the importance of the
project and on the requirements for the system/product to be built?
*
Risk Components and Drivers
● The project manager identifies the risk drivers that affect the following risk
components
● Performance risk - the degree of uncertainty that the product will meet its
requirements and be fit for its intended use
● Cost risk - the degree of uncertainty that the project budget will be maintained
● Support risk - the degree of uncertainty that the resultant software will be easy
to correct, adapt, and enhance
● Schedule risk - the degree of uncertainty that the project schedule will be
maintained and that the product will be delivered on time
● The impact of each risk driver on the risk component is divided into one of
four impact levels
● Negligible, marginal, critical, and catastrophic
● Risk drivers can be assessed as impossible, improbable, probable, and
frequent
Risk Projection (Estimation).
*

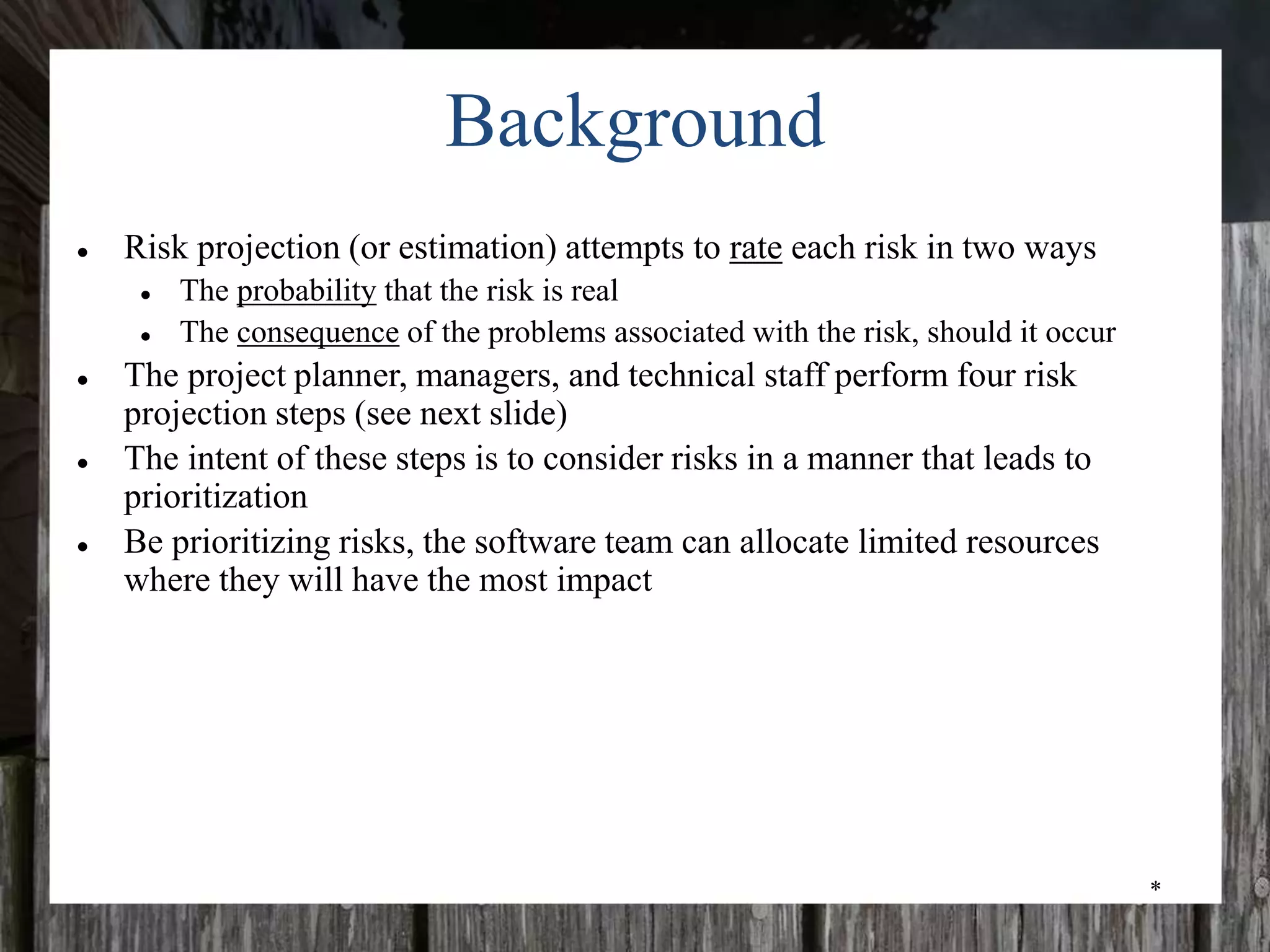

Background
● Risk projection (or estimation) attempts to rate each risk in two ways
● The probability that the risk is real
● The consequence of the problems associated with the risk, should it occur
● The project planner, managers, and technical staff perform four risk
projection steps (see next slide)
● The intent of these steps is to consider risks in a manner that leads to
prioritization
● Be prioritizing risks, the software team can allocate limited resources
where they will have the most impact
*
Risk Projection/Estimation Steps
1. Establish a scale that reflects the perceived likelihood of a risk (e.g., 1-
low, 10-high)
2. Delineate the consequences of the risk
3. Estimate the impact of the risk on the project and product
4. Note the overall accuracy of the risk projection so that there will be no
misunderstandings
*
Contents of a Risk Table
● A risk table provides a project manager with a simple technique for
risk projection
● It consists of five columns
● Risk Summary – short description of the risk
● Risk Category – one of seven risk categories (slide 12)
● Probability – estimation of risk occurrence based on group input
● Impact – (1) catastrophic (2) critical (3) marginal (4) negligible
● RMMM – Pointer to a paragraph in the Risk Mitigation, Monitoring, and
Management Plan
Risk Summary Risk Category Probability Impact (1-4) RMMM
(More on next
*

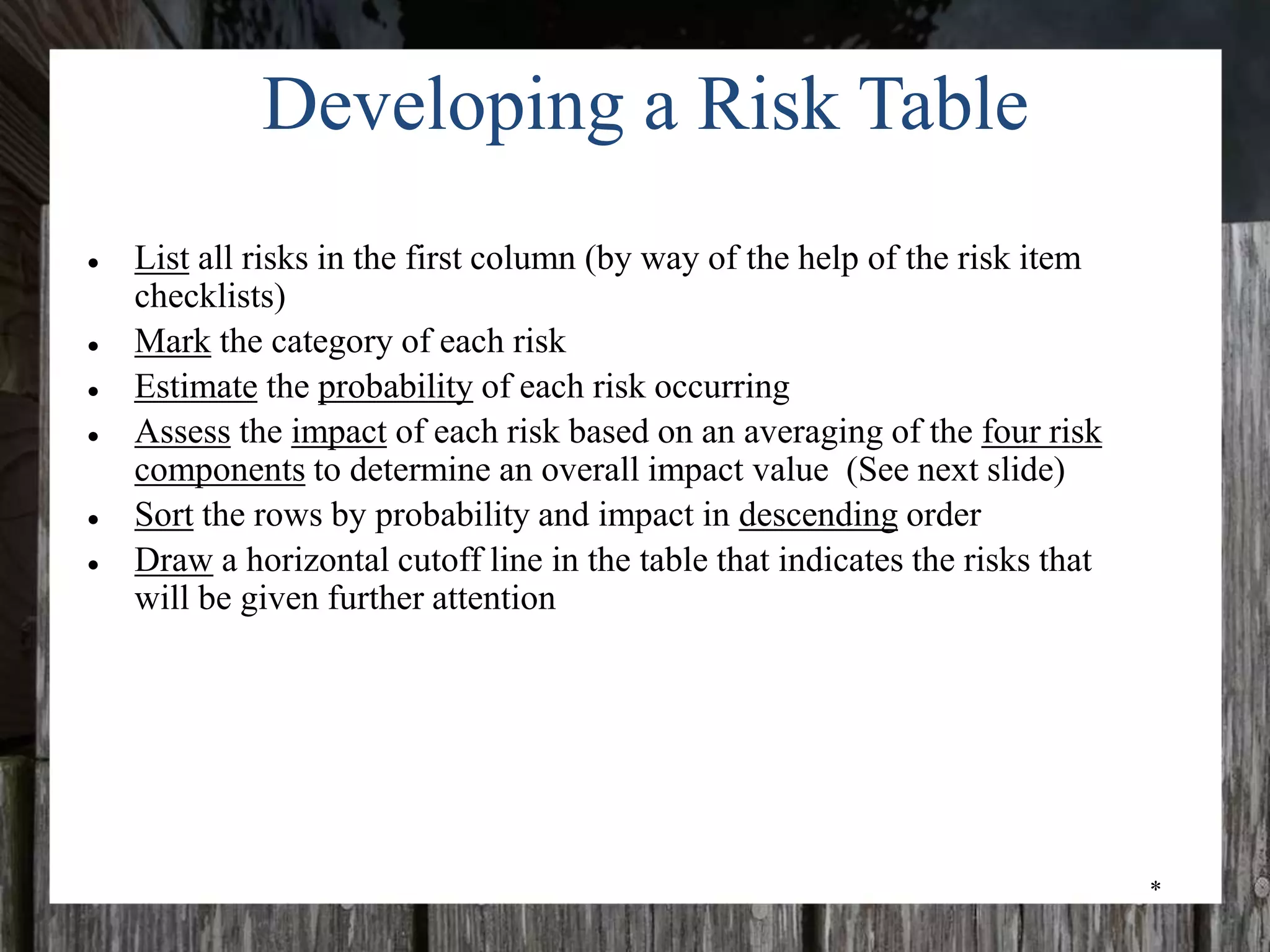

Developing a Risk Table
● List all risks in the first column (by way of the help of the risk item
checklists)
● Mark the category of each risk
● Estimate the probability of each risk occurring
● Assess the impact of each risk based on an averaging of the four risk
components to determine an overall impact value (See next slide)
● Sort the rows by probability and impact in descending order
● Draw a horizontal cutoff line in the table that indicates the risks that
will be given further attention
*
Assessing Risk Impact
● Three factors affect the consequences that are likely if a risk does occur
● Its nature – This indicates the problems that are likely if the risk occurs
● Its scope – This combines the severity of the risk (how serious was it) with its
overall distribution (how much was affected)
● Its timing – This considers when and for how long the impact will be felt
● The overall risk exposure formula is RE = P x C
● P = the probability of occurrence for a risk
● C = the cost to the project should the risk actually occur
● Example
● P = 80% probability that 18 of 60 software components will have to be developed
● C = Total cost of developing 18 components is $25,000
● RE = .80 x $25,000 = $20,000
Risk Mitigation, Monitoring, and
Management
.
*

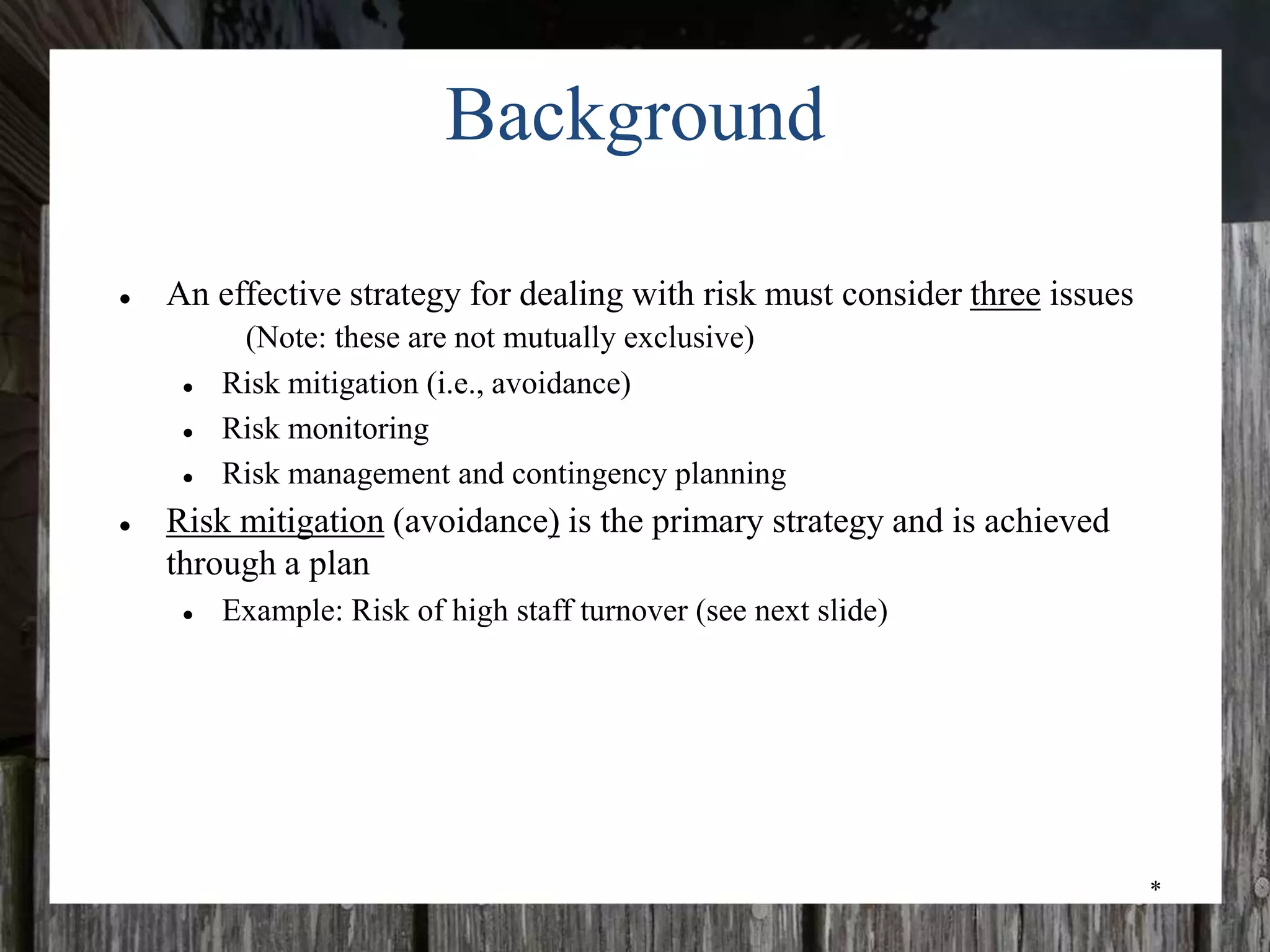

Background
● An effective strategy for dealing with risk must consider three issues
(Note: these are not mutually exclusive)
● Risk mitigation (i.e., avoidance)
● Risk monitoring
● Risk management and contingency planning
● Risk mitigation (avoidance) is the primary strategy and is achieved
through a plan

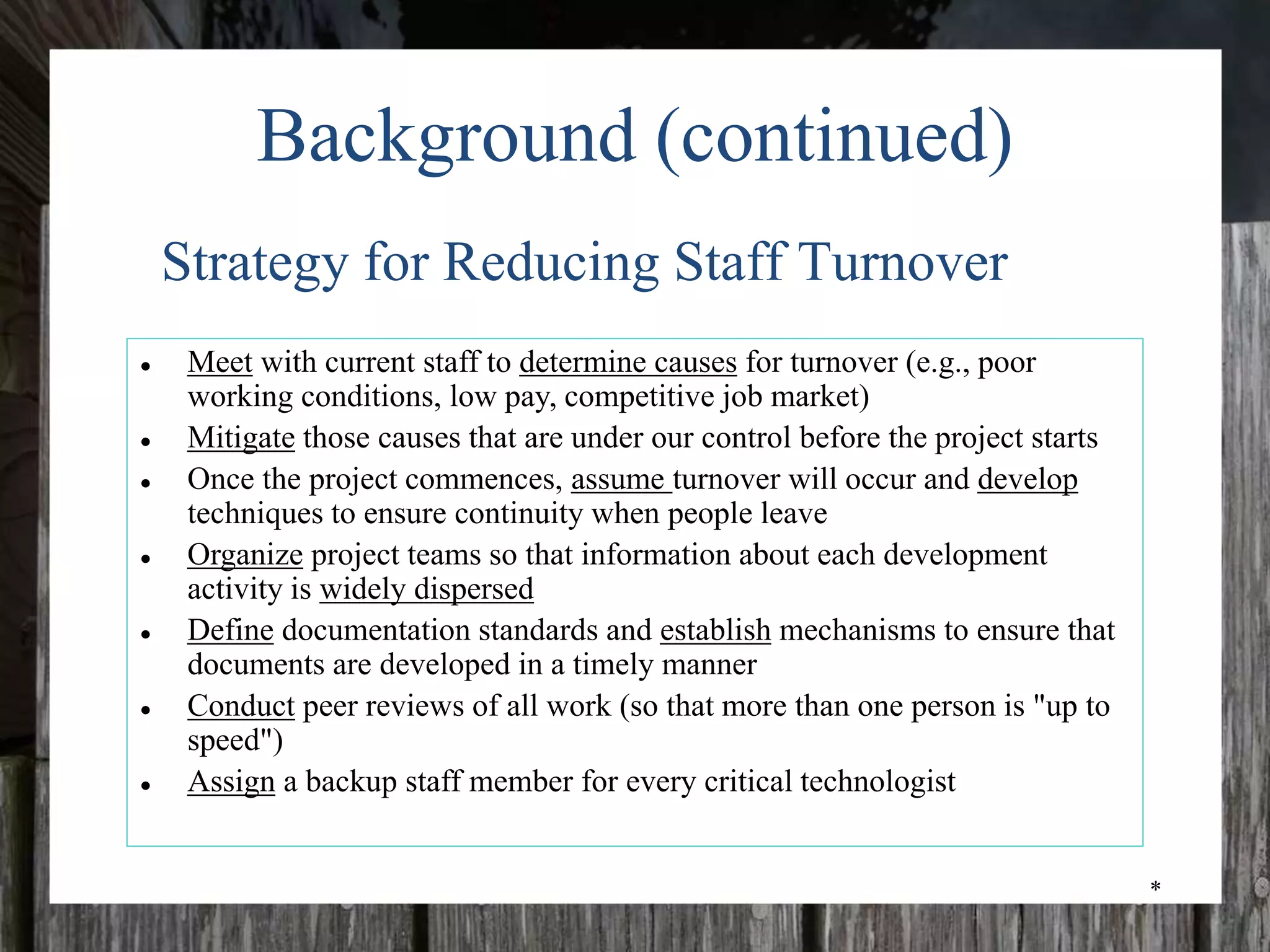

● Example: Risk of high staff turnover (see next slide)
*
Background (continued)
● Meet with current staff to determine causes for turnover (e.g., poor
working conditions, low pay, competitive job market)
● Mitigate those causes that are under our control before the project starts
● Once the project commences, assume turnover will occur and develop
techniques to ensure continuity when people leave
● Organize project teams so that information about each development
activity is widely dispersed
● Define documentation standards and establish mechanisms to ensure that
documents are developed in a timely manner
● Conduct peer reviews of all work (so that more than one person is "up to
speed")
● Assign a backup staff member for every critical technologist
Strategy for Reducing Staff Turnover
*
Background (continued)
● During risk monitoring, the project manager monitors factors that may
provide an indication of whether a risk is becoming more or less likely
● Risk management and contingency planning assume that mitigation
efforts have failed and that the risk has become a reality
● RMMM steps incur additional project cost
● Large projects may have identified 30 – 40 risks
● Risk is not limited to the software project itself
● Risks can occur after the software has been delivered to the user
*
Background (continued)
● Software safety and hazard analysis
● These are software quality assurance activities that focus on the
identification and assessment of potential hazards that may affect software
negatively and cause an entire system to fail
● If hazards can be identified early in the software process, software design
features can be specified that will either eliminate or control potential
hazards
*
The RMMM Plan
● The RMMM plan may be a part of the software development plan.
● Once RMMM has been documented and the project has begun, the risk
mitigation, and monitoring steps begin
● Risk mitigation is a problem avoidance activity
● Risk monitoring is a project tracking activity
● Risk monitoring has three objectives
● To assess whether predicted risks do, in fact, occur
● To ensure that risk aversion steps defined for the risk are being properly
applied
● To collect information that can be used for future risk analysis
● The findings from risk monitoring may allow the project manager to
ascertain what risks caused which problems throughout the project
*
Seven Principles of Risk Management
● Maintain a global perspective
● View software risks within the context of a system and the business
problem that is is intended to solve
● Take a forward-looking view
● Think about risks that may arise in the future; establish contingency plans
● Encourage open communication
● Encourage all stakeholders and users to point out risks at any time
● Integrate risk management
● Integrate the consideration of risk into the software process
● Emphasize a continuous process of risk management
● Modify identified risks as more becomes known and add new risks as
better insight is achieved
● Develop a shared product vision
● A shared vision by all stakeholders facilitates better risk identification and
assessment
● Encourage teamwork when managing risk
● Pool the skills and experience of all stakeholders when conducting risk
management activities
*
Summary
● Whenever much is riding on a software project, common sense dictates risk
analysis
● Yet, most project managers do it informally and superficially, if at all
● However, the time spent in risk management results in
● Less upheaval during the project
● A greater ability to track and control a project
● The confidence that comes with planning for problems before they occur
● Risk management can absorb a significant amount of the project planning
effort…but the effort is worth it
☺

More Related Content

What's hot

Risk Identification.ppt
Risk Identification.pptRisk Identification.ppt
Risk Identification.ppt
Avicenna6

Project risk management
Project risk managementProject risk management
Project risk management
Dewang Agrawal

Risk-management
 Risk-management Risk-management
Risk-management
Umesh Gupta

Risk Management
Risk ManagementRisk Management
Risk Management
Stefan Csosz

Risk Mitigation, Monitoring and Management Plan (RMMM)
Risk Mitigation, Monitoring and Management Plan (RMMM)Risk Mitigation, Monitoring and Management Plan (RMMM)
Risk Mitigation, Monitoring and Management Plan (RMMM)
Navjyotsinh Jadeja

Risk Management
Risk ManagementRisk Management
Risk Management
Hinal Lunagariya

Risk Management
Risk ManagementRisk Management
Risk Management
cgeorgeo

Project risk management
Project risk managementProject risk management
Project risk management
Aswin prakash i , Xantus Technologies

Project Risk Management
Project Risk ManagementProject Risk Management
Project Risk Management
cgautam

Risk Management
Risk ManagementRisk Management
Risk Management
vivekaathuri

Risk Management
Risk ManagementRisk Management
Risk Management
Saqib Raza

risk management
risk managementrisk management
risk management
Arti Maggo

Risk management
Risk managementRisk management
Risk management
Harold Malamion

Risk management
Risk management Risk management
Risk management
mamta bhaurya

Projectriskmanagement pmbok5
Projectriskmanagement pmbok5Projectriskmanagement pmbok5
Projectriskmanagement pmbok5
Dhamo daran

Project Risk Management
 Project Risk Management Project Risk Management
Project Risk Management
Hayat Denzi

Unit 8-risk manaegement (1) -
Unit 8-risk manaegement (1) - Unit 8-risk manaegement (1) -
Unit 8-risk manaegement (1) -
Shashi Kumar

Risk management in software engineering
Risk management in software engineeringRisk management in software engineering
Risk management in software engineering
deep sharma

Risk management
Risk managementRisk management
Risk management
Manish Tiwari

Risk Management
Risk ManagementRisk Management
Risk Management
Shahan Ullah


What's hot (20)

Risk Identification.ppt
Risk Identification.pptRisk Identification.ppt
Risk Identification.ppt

Project risk management
Project risk managementProject risk management
Project risk management

Risk-management
 Risk-management Risk-management
Risk-management

Risk Management
Risk ManagementRisk Management
Risk Management

Risk Mitigation, Monitoring and Management Plan (RMMM)
Risk Mitigation, Monitoring and Management Plan (RMMM)Risk Mitigation, Monitoring and Management Plan (RMMM)
Risk Mitigation, Monitoring and Management Plan (RMMM)

Risk Management
Risk ManagementRisk Management
Risk Management

Risk Management
Risk ManagementRisk Management
Risk Management

Project risk management
Project risk managementProject risk management
Project risk management

Project Risk Management
Project Risk ManagementProject Risk Management
Project Risk Management

Risk Management
Risk ManagementRisk Management
Risk Management

Risk Management
Risk ManagementRisk Management
Risk Management

risk management
risk managementrisk management
risk management

Risk management
Risk managementRisk management
Risk management

Risk management
Risk management Risk management
Risk management

Projectriskmanagement pmbok5
Projectriskmanagement pmbok5Projectriskmanagement pmbok5
Projectriskmanagement pmbok5

Project Risk Management
 Project Risk Management Project Risk Management
Project Risk Management

Unit 8-risk manaegement (1) -
Unit 8-risk manaegement (1) - Unit 8-risk manaegement (1) -
Unit 8-risk manaegement (1) -

Risk management in software engineering
Risk management in software engineeringRisk management in software engineering
Risk management in software engineering

Risk management
Risk managementRisk management
Risk management

Risk Management
Risk ManagementRisk Management
Risk Management


Viewers also liked

RMMM-Risk Management,Mitigation and Monitoring.
RMMM-Risk Management,Mitigation and Monitoring.RMMM-Risk Management,Mitigation and Monitoring.
RMMM-Risk Management,Mitigation and Monitoring.
Aparna Nayak

Real Estate Lending and Sustainability: The Business Case for Risk Management...
Real Estate Lending and Sustainability: The Business Case for Risk Management...Real Estate Lending and Sustainability: The Business Case for Risk Management...
Real Estate Lending and Sustainability: The Business Case for Risk Management...
GRESB

Online Retail Risk Management
Online Retail Risk ManagementOnline Retail Risk Management
Online Retail Risk Managementiamwire

RMMM Plan
RMMM PlanRMMM Plan
RMMM Plan
Ankit Bahuguna

Risk Management Assignment
Risk Management AssignmentRisk Management Assignment
Risk Management Assignment
Fotios N. Zachopoulos

Online voting system project
Online voting system projectOnline voting system project
Online voting system projectsnauriyal1994


Viewers also liked (6)

RMMM-Risk Management,Mitigation and Monitoring.
RMMM-Risk Management,Mitigation and Monitoring.RMMM-Risk Management,Mitigation and Monitoring.
RMMM-Risk Management,Mitigation and Monitoring.

Real Estate Lending and Sustainability: The Business Case for Risk Management...
Real Estate Lending and Sustainability: The Business Case for Risk Management...Real Estate Lending and Sustainability: The Business Case for Risk Management...
Real Estate Lending and Sustainability: The Business Case for Risk Management...

Online Retail Risk Management
Online Retail Risk ManagementOnline Retail Risk Management
Online Retail Risk Management

RMMM Plan
RMMM PlanRMMM Plan
RMMM Plan

Risk Management Assignment
Risk Management AssignmentRisk Management Assignment
Risk Management Assignment

Online voting system project
Online voting system projectOnline voting system project
Online voting system project


Similar to Risk management

Riskmanagement software Engineering1.ppt
Riskmanagement software Engineering1.pptRiskmanagement software Engineering1.ppt
Riskmanagement software Engineering1.ppt
sirishaYerraboina1

Pressman ch-25-risk-management
Pressman ch-25-risk-managementPressman ch-25-risk-management
Pressman ch-25-risk-management
zeeshanwrch

RMMM
RMMMRMMM
pressman-ch-25-chapte risk-management.ppt
pressman-ch-25-chapte risk-management.pptpressman-ch-25-chapte risk-management.ppt
pressman-ch-25-chapte risk-management.ppt
KhajaPasha33

pressman-ch-25-risk-management.ppt
pressman-ch-25-risk-management.pptpressman-ch-25-risk-management.ppt
pressman-ch-25-risk-management.ppt
MuhammadKashif703372

risk-management-121021125051-phpapp02 (1).pdf
risk-management-121021125051-phpapp02 (1).pdfrisk-management-121021125051-phpapp02 (1).pdf
risk-management-121021125051-phpapp02 (1).pdf
PriyanshTan

OOSE-PRESENTATION.pptx
OOSE-PRESENTATION.pptxOOSE-PRESENTATION.pptx
OOSE-PRESENTATION.pptx
RanjitKdk

Project Management C7 -risk_management
Project Management C7  -risk_managementProject Management C7  -risk_management
Project Management C7 -risk_managementIzah Asmadi

Bai giang-spm-06mar14
Bai giang-spm-06mar14Bai giang-spm-06mar14
riskanalysis-120305101118-phpapp02.pdf
riskanalysis-120305101118-phpapp02.pdfriskanalysis-120305101118-phpapp02.pdf
riskanalysis-120305101118-phpapp02.pdf
WilliamTom9

Software Engineering (Risk Management)
Software Engineering (Risk Management)Software Engineering (Risk Management)
Software Engineering (Risk Management)
ShudipPal

Risk management(software engineering)
Risk management(software engineering)Risk management(software engineering)
Risk management(software engineering)
Priya Tomar

Project risk analysis
Project risk analysisProject risk analysis
Project risk analysis
SUBHASISHMAHAKUD

PPT SE SACHIN.ppt
PPT SE SACHIN.pptPPT SE SACHIN.ppt
PPT SE SACHIN.ppt
SACHINMAURYA57

Risk-Management-05012023-025512pm.ppt
Risk-Management-05012023-025512pm.pptRisk-Management-05012023-025512pm.ppt
Risk-Management-05012023-025512pm.ppt
YasirShaikh34

PROJECT RISK MANAGEMENT.pdf
PROJECT RISK MANAGEMENT.pdfPROJECT RISK MANAGEMENT.pdf
PROJECT RISK MANAGEMENT.pdf
MUST

Unit 7 final
Unit 7 finalUnit 7 final
Unit 7 finalsietkcse


Similar to Risk management (20)

Riskmanagement software Engineering1.ppt
Riskmanagement software Engineering1.pptRiskmanagement software Engineering1.ppt
Riskmanagement software Engineering1.ppt

Pressman ch-25-risk-management
Pressman ch-25-risk-managementPressman ch-25-risk-management
Pressman ch-25-risk-management

RMMM
RMMMRMMM
RMMM

pressman-ch-25-chapte risk-management.ppt
pressman-ch-25-chapte risk-management.pptpressman-ch-25-chapte risk-management.ppt
pressman-ch-25-chapte risk-management.ppt

pressman-ch-25-risk-management.ppt
pressman-ch-25-risk-management.pptpressman-ch-25-risk-management.ppt
pressman-ch-25-risk-management.ppt

risk-management-121021125051-phpapp02 (1).pdf
risk-management-121021125051-phpapp02 (1).pdfrisk-management-121021125051-phpapp02 (1).pdf
risk-management-121021125051-phpapp02 (1).pdf

OOSE-PRESENTATION.pptx
OOSE-PRESENTATION.pptxOOSE-PRESENTATION.pptx
OOSE-PRESENTATION.pptx

Project Management C7 -risk_management
Project Management C7  -risk_managementProject Management C7  -risk_management
Project Management C7 -risk_management

Risk
RiskRisk
Risk

Bai giang-spm-06mar14
Bai giang-spm-06mar14Bai giang-spm-06mar14
Bai giang-spm-06mar14

riskanalysis-120305101118-phpapp02.pdf
riskanalysis-120305101118-phpapp02.pdfriskanalysis-120305101118-phpapp02.pdf
riskanalysis-120305101118-phpapp02.pdf

Software Engineering (Risk Management)
Software Engineering (Risk Management)Software Engineering (Risk Management)
Software Engineering (Risk Management)

Risk management(software engineering)
Risk management(software engineering)Risk management(software engineering)
Risk management(software engineering)

Project risk analysis
Project risk analysisProject risk analysis
Project risk analysis

PPT SE SACHIN.ppt
PPT SE SACHIN.pptPPT SE SACHIN.ppt
PPT SE SACHIN.ppt

Risk management
Risk managementRisk management
Risk management

Unit 7
Unit 7Unit 7
Unit 7

Risk-Management-05012023-025512pm.ppt
Risk-Management-05012023-025512pm.pptRisk-Management-05012023-025512pm.ppt
Risk-Management-05012023-025512pm.ppt

PROJECT RISK MANAGEMENT.pdf
PROJECT RISK MANAGEMENT.pdfPROJECT RISK MANAGEMENT.pdf
PROJECT RISK MANAGEMENT.pdf

Unit 7 final
Unit 7 finalUnit 7 final
Unit 7 final


More from Usman Mukhtar

Software reliability
Software reliability Software reliability
Software reliability
Usman Mukhtar

Ethics in research
Ethics in researchEthics in research
Ethics in research
Usman Mukhtar

user support system in HCI
user support system in HCIuser support system in HCI
user support system in HCI
Usman Mukhtar

LRA and TORA in MANETS
LRA and TORA in MANETSLRA and TORA in MANETS
LRA and TORA in MANETSUsman Mukhtar

Network security policies
Network security policiesNetwork security policies
Network security policiesUsman Mukhtar

information system of NBP
information system of NBPinformation system of NBP
information system of NBPUsman Mukhtar


More from Usman Mukhtar (6)

Software reliability
Software reliability Software reliability
Software reliability

Ethics in research
Ethics in researchEthics in research
Ethics in research

user support system in HCI
user support system in HCIuser support system in HCI
user support system in HCI

LRA and TORA in MANETS
LRA and TORA in MANETSLRA and TORA in MANETS
LRA and TORA in MANETS

Network security policies
Network security policiesNetwork security policies
Network security policies

information system of NBP
information system of NBPinformation system of NBP
information system of NBP


Recently uploaded

Key Trends Shaping the Future of Infrastructure.pdf
Key Trends Shaping the Future of Infrastructure.pdfKey Trends Shaping the Future of Infrastructure.pdf
Key Trends Shaping the Future of Infrastructure.pdf
Cheryl Hung

Unsubscribed: Combat Subscription Fatigue With a Membership Mentality by Head...
Unsubscribed: Combat Subscription Fatigue With a Membership Mentality by Head...Unsubscribed: Combat Subscription Fatigue With a Membership Mentality by Head...
Unsubscribed: Combat Subscription Fatigue With a Membership Mentality by Head...
Product School

De-mystifying Zero to One: Design Informed Techniques for Greenfield Innovati...
De-mystifying Zero to One: Design Informed Techniques for Greenfield Innovati...De-mystifying Zero to One: Design Informed Techniques for Greenfield Innovati...
De-mystifying Zero to One: Design Informed Techniques for Greenfield Innovati...
Product School

FIDO Alliance Osaka Seminar: FIDO Security Aspects.pdf
FIDO Alliance Osaka Seminar: FIDO Security Aspects.pdfFIDO Alliance Osaka Seminar: FIDO Security Aspects.pdf
FIDO Alliance Osaka Seminar: FIDO Security Aspects.pdf
FIDO Alliance

Dev Dives: Train smarter, not harder – active learning and UiPath LLMs for do...
Dev Dives: Train smarter, not harder – active learning and UiPath LLMs for do...Dev Dives: Train smarter, not harder – active learning and UiPath LLMs for do...
Dev Dives: Train smarter, not harder – active learning and UiPath LLMs for do...
UiPathCommunity

FIDO Alliance Osaka Seminar: Passkeys at Amazon.pdf
FIDO Alliance Osaka Seminar: Passkeys at Amazon.pdfFIDO Alliance Osaka Seminar: Passkeys at Amazon.pdf
FIDO Alliance Osaka Seminar: Passkeys at Amazon.pdf
FIDO Alliance

GDG Cloud Southlake #33: Boule & Rebala: Effective AppSec in SDLC using Deplo...
GDG Cloud Southlake #33: Boule & Rebala: Effective AppSec in SDLC using Deplo...GDG Cloud Southlake #33: Boule & Rebala: Effective AppSec in SDLC using Deplo...
GDG Cloud Southlake #33: Boule & Rebala: Effective AppSec in SDLC using Deplo...
James Anderson

Slack (or Teams) Automation for Bonterra Impact Management (fka Social Soluti...
Slack (or Teams) Automation for Bonterra Impact Management (fka Social Soluti...Slack (or Teams) Automation for Bonterra Impact Management (fka Social Soluti...
Slack (or Teams) Automation for Bonterra Impact Management (fka Social Soluti...
Jeffrey Haguewood

FIDO Alliance Osaka Seminar: Passkeys and the Road Ahead.pdf
FIDO Alliance Osaka Seminar: Passkeys and the Road Ahead.pdfFIDO Alliance Osaka Seminar: Passkeys and the Road Ahead.pdf
FIDO Alliance Osaka Seminar: Passkeys and the Road Ahead.pdf
FIDO Alliance

Neuro-symbolic is not enough, we need neuro-*semantic*
Neuro-symbolic is not enough, we need neuro-*semantic*Neuro-symbolic is not enough, we need neuro-*semantic*
Neuro-symbolic is not enough, we need neuro-*semantic*
Frank van Harmelen

LF Energy Webinar: Electrical Grid Modelling and Simulation Through PowSyBl -...
LF Energy Webinar: Electrical Grid Modelling and Simulation Through PowSyBl -...LF Energy Webinar: Electrical Grid Modelling and Simulation Through PowSyBl -...
LF Energy Webinar: Electrical Grid Modelling and Simulation Through PowSyBl -...
DanBrown980551

Encryption in Microsoft 365 - ExpertsLive Netherlands 2024
Encryption in Microsoft 365 - ExpertsLive Netherlands 2024Encryption in Microsoft 365 - ExpertsLive Netherlands 2024
Encryption in Microsoft 365 - ExpertsLive Netherlands 2024
Albert Hoitingh

FIDO Alliance Osaka Seminar: Overview.pdf
FIDO Alliance Osaka Seminar: Overview.pdfFIDO Alliance Osaka Seminar: Overview.pdf
FIDO Alliance Osaka Seminar: Overview.pdf
FIDO Alliance

Epistemic Interaction - tuning interfaces to provide information for AI support
Epistemic Interaction - tuning interfaces to provide information for AI supportEpistemic Interaction - tuning interfaces to provide information for AI support
Epistemic Interaction - tuning interfaces to provide information for AI support
Alan Dix

Smart TV Buyer Insights Survey 2024 by 91mobiles.pdf
Smart TV Buyer Insights Survey 2024 by 91mobiles.pdfSmart TV Buyer Insights Survey 2024 by 91mobiles.pdf
Smart TV Buyer Insights Survey 2024 by 91mobiles.pdf
91mobiles

Builder.ai Founder Sachin Dev Duggal's Strategic Approach to Create an Innova...
Builder.ai Founder Sachin Dev Duggal's Strategic Approach to Create an Innova...Builder.ai Founder Sachin Dev Duggal's Strategic Approach to Create an Innova...
Builder.ai Founder Sachin Dev Duggal's Strategic Approach to Create an Innova...
Ramesh Iyer

Transcript: Selling digital books in 2024: Insights from industry leaders - T...
Transcript: Selling digital books in 2024: Insights from industry leaders - T...Transcript: Selling digital books in 2024: Insights from industry leaders - T...
Transcript: Selling digital books in 2024: Insights from industry leaders - T...
BookNet Canada

UiPath Test Automation using UiPath Test Suite series, part 3
UiPath Test Automation using UiPath Test Suite series, part 3UiPath Test Automation using UiPath Test Suite series, part 3
UiPath Test Automation using UiPath Test Suite series, part 3
DianaGray10

PCI PIN Basics Webinar from the Controlcase Team
PCI PIN Basics Webinar from the Controlcase TeamPCI PIN Basics Webinar from the Controlcase Team
PCI PIN Basics Webinar from the Controlcase Team
ControlCase

Monitoring Java Application Security with JDK Tools and JFR Events
Monitoring Java Application Security with JDK Tools and JFR EventsMonitoring Java Application Security with JDK Tools and JFR Events
Monitoring Java Application Security with JDK Tools and JFR Events
Ana-Maria Mihalceanu


Recently uploaded (20)

Key Trends Shaping the Future of Infrastructure.pdf
Key Trends Shaping the Future of Infrastructure.pdfKey Trends Shaping the Future of Infrastructure.pdf
Key Trends Shaping the Future of Infrastructure.pdf

Unsubscribed: Combat Subscription Fatigue With a Membership Mentality by Head...
Unsubscribed: Combat Subscription Fatigue With a Membership Mentality by Head...Unsubscribed: Combat Subscription Fatigue With a Membership Mentality by Head...
Unsubscribed: Combat Subscription Fatigue With a Membership Mentality by Head...

De-mystifying Zero to One: Design Informed Techniques for Greenfield Innovati...
De-mystifying Zero to One: Design Informed Techniques for Greenfield Innovati...De-mystifying Zero to One: Design Informed Techniques for Greenfield Innovati...
De-mystifying Zero to One: Design Informed Techniques for Greenfield Innovati...

FIDO Alliance Osaka Seminar: FIDO Security Aspects.pdf
FIDO Alliance Osaka Seminar: FIDO Security Aspects.pdfFIDO Alliance Osaka Seminar: FIDO Security Aspects.pdf
FIDO Alliance Osaka Seminar: FIDO Security Aspects.pdf

Dev Dives: Train smarter, not harder – active learning and UiPath LLMs for do...
Dev Dives: Train smarter, not harder – active learning and UiPath LLMs for do...Dev Dives: Train smarter, not harder – active learning and UiPath LLMs for do...
Dev Dives: Train smarter, not harder – active learning and UiPath LLMs for do...

FIDO Alliance Osaka Seminar: Passkeys at Amazon.pdf
FIDO Alliance Osaka Seminar: Passkeys at Amazon.pdfFIDO Alliance Osaka Seminar: Passkeys at Amazon.pdf
FIDO Alliance Osaka Seminar: Passkeys at Amazon.pdf

GDG Cloud Southlake #33: Boule & Rebala: Effective AppSec in SDLC using Deplo...
GDG Cloud Southlake #33: Boule & Rebala: Effective AppSec in SDLC using Deplo...GDG Cloud Southlake #33: Boule & Rebala: Effective AppSec in SDLC using Deplo...
GDG Cloud Southlake #33: Boule & Rebala: Effective AppSec in SDLC using Deplo...

Slack (or Teams) Automation for Bonterra Impact Management (fka Social Soluti...
Slack (or Teams) Automation for Bonterra Impact Management (fka Social Soluti...Slack (or Teams) Automation for Bonterra Impact Management (fka Social Soluti...
Slack (or Teams) Automation for Bonterra Impact Management (fka Social Soluti...

FIDO Alliance Osaka Seminar: Passkeys and the Road Ahead.pdf
FIDO Alliance Osaka Seminar: Passkeys and the Road Ahead.pdfFIDO Alliance Osaka Seminar: Passkeys and the Road Ahead.pdf
FIDO Alliance Osaka Seminar: Passkeys and the Road Ahead.pdf

Neuro-symbolic is not enough, we need neuro-*semantic*
Neuro-symbolic is not enough, we need neuro-*semantic*Neuro-symbolic is not enough, we need neuro-*semantic*
Neuro-symbolic is not enough, we need neuro-*semantic*

LF Energy Webinar: Electrical Grid Modelling and Simulation Through PowSyBl -...
LF Energy Webinar: Electrical Grid Modelling and Simulation Through PowSyBl -...LF Energy Webinar: Electrical Grid Modelling and Simulation Through PowSyBl -...
LF Energy Webinar: Electrical Grid Modelling and Simulation Through PowSyBl -...

Encryption in Microsoft 365 - ExpertsLive Netherlands 2024
Encryption in Microsoft 365 - ExpertsLive Netherlands 2024Encryption in Microsoft 365 - ExpertsLive Netherlands 2024
Encryption in Microsoft 365 - ExpertsLive Netherlands 2024

FIDO Alliance Osaka Seminar: Overview.pdf
FIDO Alliance Osaka Seminar: Overview.pdfFIDO Alliance Osaka Seminar: Overview.pdf
FIDO Alliance Osaka Seminar: Overview.pdf

Epistemic Interaction - tuning interfaces to provide information for AI support
Epistemic Interaction - tuning interfaces to provide information for AI supportEpistemic Interaction - tuning interfaces to provide information for AI support
Epistemic Interaction - tuning interfaces to provide information for AI support

Smart TV Buyer Insights Survey 2024 by 91mobiles.pdf
Smart TV Buyer Insights Survey 2024 by 91mobiles.pdfSmart TV Buyer Insights Survey 2024 by 91mobiles.pdf
Smart TV Buyer Insights Survey 2024 by 91mobiles.pdf

Builder.ai Founder Sachin Dev Duggal's Strategic Approach to Create an Innova...
Builder.ai Founder Sachin Dev Duggal's Strategic Approach to Create an Innova...Builder.ai Founder Sachin Dev Duggal's Strategic Approach to Create an Innova...
Builder.ai Founder Sachin Dev Duggal's Strategic Approach to Create an Innova...

Transcript: Selling digital books in 2024: Insights from industry leaders - T...
Transcript: Selling digital books in 2024: Insights from industry leaders - T...Transcript: Selling digital books in 2024: Insights from industry leaders - T...
Transcript: Selling digital books in 2024: Insights from industry leaders - T...

UiPath Test Automation using UiPath Test Suite series, part 3
UiPath Test Automation using UiPath Test Suite series, part 3UiPath Test Automation using UiPath Test Suite series, part 3
UiPath Test Automation using UiPath Test Suite series, part 3

PCI PIN Basics Webinar from the Controlcase Team
PCI PIN Basics Webinar from the Controlcase TeamPCI PIN Basics Webinar from the Controlcase Team
PCI PIN Basics Webinar from the Controlcase Team

Monitoring Java Application Security with JDK Tools and JFR Events
Monitoring Java Application Security with JDK Tools and JFR EventsMonitoring Java Application Security with JDK Tools and JFR Events
Monitoring Java Application Security with JDK Tools and JFR Events


Risk management

  • 1. Risk Management ● Introduction ● Risk identification ● Risk projection (estimation) ● Risk mitigation, monitoring, and management )
  • 3. * Definition of Risk ● A risk is a potential problem – it might happen and it might not ● Conceptual definition of risk ● Risk concerns future happenings ● Risk involves change in mind, opinion, actions, places, etc. ● Risk involves choice and the uncertainty that choice entails ● Two characteristics of risk ● Uncertainty – the risk may or may not happen, that is, there are no 100% risks (those, instead, are called constraints) ● Loss – the risk becomes a reality and unwanted consequences or losses occur
  • 4. * Risk Categorization – Approach #1 ● Project risks ● They threaten the project plan ● If they become real, it is likely that the project schedule will slip and that costs will increase ● Technical risks ● They threaten the quality and timeliness of the software to be produced ● If they become real, implementation may become difficult or impossible ● Business risks ● They threaten the viability of the software to be built ● If they become real, they jeopardize the project or the product (More on next slide)
  • 5. * Risk Categorization – Approach #1 (continued) ● Sub-categories of Business risks ● Market risk – building an excellent product or system that no one really wants ● Strategic risk – building a product that no longer fits into the overall business strategy for the company ● Sales risk – building a product that the sales force doesn't understand how to sell ● Management risk – losing the support of senior management due to a change in focus or a change in people ● Budget risk – losing budgetary or personnel commitment
  • 6. * Risk Categorization – Approach #2 ● Known risks ● Those risks that can be uncovered after careful evaluation of the project plan, the business and technical environment in which the project is being developed, and other reliable information sources (e.g., unrealistic delivery date) ● Predictable risks ● Those risks that are extrapolated from past project experience (e.g., past turnover) ● Unpredictable risks ● Those risks that can and do occur, but are extremely difficult to identify in advance
  • 7. * Reactive vs. Proactive Risk Strategies ● Reactive risk strategies ● "Don't worry, I'll think of something" ● The majority of software teams and managers rely on this approach ● Nothing is done about risks until something goes wrong ● The team then flies into action in an attempt to correct the problem rapidly (fire fighting) ● Crisis management is the choice of management techniques ● Proactive risk strategies ● Steps for risk management are followed (see next slide) ● Primary objective is to avoid risk and to have a contingency plan in place to handle unavoidable risks in a controlled and effective manner
  • 8. * Steps for Risk Management 1. Identify possible risks; recognize what can go wrong 2. Analyze each risk to estimate the probability that it will occur and the impact (i.e., damage) that it will do if it does occur 3. Rank the risks by probability and impact - Impact may be negligible, marginal, critical, and catastrophic 4. Develop a contingency plan to manage those risks having high probability and high impact
  • 10. * Background ● Risk identification is a systematic attempt to specify threats to the project plan ● By identifying known and predictable risks, the project manager takes a first step toward avoiding them when possible and controlling them when necessary ● Generic risks ● Risks that are a potential threat to every software project ● Product-specific risks ● Risks that can be identified only by those a with a clear understanding of the technology, the people, and the environment that is specific to the software that is to be built ● This requires examination of the project plan and the statement of scope ● "What special characteristics of this product may threaten our project plan?"
  • 11. * Risk Item Checklist ● Used as one way to identify risks ● Focuses on known and predictable risks in specific subcategories (see next slide) ● Can be organized in several ways ● A list of characteristics relevant to each risk subcategory ● Questionnaire that leads to an estimate on the impact of each risk ● A list containing a set of risk component and drivers and their probability of occurrence
  • 12. * Known and Predictable Risk Categories ● Product size – risks associated with overall size of the software to be built ● Business impact – risks associated with constraints imposed by management or the marketplace ● Customer characteristics – risks associated with sophistication of the customer and the developer's ability to communicate with the customer in a timely manner ● Process definition – risks associated with the degree to which the software process has been defined and is followed ● Development environment – risks associated with availability and quality of the tools to be used to build the project ● Technology to be built – risks associated with complexity of the system to be built and the "newness" of the technology in the system ● Staff size and experience – risks associated with overall technical and project experience of the software engineers who will do the work
  • 13. * Questionnaire on Project Risk 1. Have top software and customer managers formally committed to support the project? 2. Are end-users enthusiastically committed to the project and the system/product to be built? 3. Are requirements fully understood by the software engineering team and its customers? 4. Have customers been involved fully in the definition of requirements? 5. Do end-users have realistic expectations? 6. Is the project scope stable? (Questions are ordered by their relative importance to project success) (More on next
  • 14. * Questionnaire on Project Risk (continued) 7. Does the software engineering team have the right mix of skills? 8. Are project requirements stable? 9. Does the project team have experience with the technology to be implemented? 10. Is the number of people on the project team adequate to do the job? 11. Do all customer/user constituencies agree on the importance of the project and on the requirements for the system/product to be built?
  • 15. * Risk Components and Drivers ● The project manager identifies the risk drivers that affect the following risk components ● Performance risk - the degree of uncertainty that the product will meet its requirements and be fit for its intended use ● Cost risk - the degree of uncertainty that the project budget will be maintained ● Support risk - the degree of uncertainty that the resultant software will be easy to correct, adapt, and enhance ● Schedule risk - the degree of uncertainty that the project schedule will be maintained and that the product will be delivered on time ● The impact of each risk driver on the risk component is divided into one of four impact levels ● Negligible, marginal, critical, and catastrophic ● Risk drivers can be assessed as impossible, improbable, probable, and frequent
  • 17. * Background ● Risk projection (or estimation) attempts to rate each risk in two ways ● The probability that the risk is real ● The consequence of the problems associated with the risk, should it occur ● The project planner, managers, and technical staff perform four risk projection steps (see next slide) ● The intent of these steps is to consider risks in a manner that leads to prioritization ● Be prioritizing risks, the software team can allocate limited resources where they will have the most impact
  • 18. * Risk Projection/Estimation Steps 1. Establish a scale that reflects the perceived likelihood of a risk (e.g., 1- low, 10-high) 2. Delineate the consequences of the risk 3. Estimate the impact of the risk on the project and product 4. Note the overall accuracy of the risk projection so that there will be no misunderstandings
  • 19. * Contents of a Risk Table ● A risk table provides a project manager with a simple technique for risk projection ● It consists of five columns ● Risk Summary – short description of the risk ● Risk Category – one of seven risk categories (slide 12) ● Probability – estimation of risk occurrence based on group input ● Impact – (1) catastrophic (2) critical (3) marginal (4) negligible ● RMMM – Pointer to a paragraph in the Risk Mitigation, Monitoring, and Management Plan Risk Summary Risk Category Probability Impact (1-4) RMMM (More on next
  • 20. * Developing a Risk Table ● List all risks in the first column (by way of the help of the risk item checklists) ● Mark the category of each risk ● Estimate the probability of each risk occurring ● Assess the impact of each risk based on an averaging of the four risk components to determine an overall impact value (See next slide) ● Sort the rows by probability and impact in descending order ● Draw a horizontal cutoff line in the table that indicates the risks that will be given further attention
  • 21. * Assessing Risk Impact ● Three factors affect the consequences that are likely if a risk does occur ● Its nature – This indicates the problems that are likely if the risk occurs ● Its scope – This combines the severity of the risk (how serious was it) with its overall distribution (how much was affected) ● Its timing – This considers when and for how long the impact will be felt ● The overall risk exposure formula is RE = P x C ● P = the probability of occurrence for a risk ● C = the cost to the project should the risk actually occur ● Example ● P = 80% probability that 18 of 60 software components will have to be developed ● C = Total cost of developing 18 components is $25,000 ● RE = .80 x $25,000 = $20,000
  • 22. Risk Mitigation, Monitoring, and Management .
  • 23. * Background ● An effective strategy for dealing with risk must consider three issues (Note: these are not mutually exclusive) ● Risk mitigation (i.e., avoidance) ● Risk monitoring ● Risk management and contingency planning ● Risk mitigation (avoidance) is the primary strategy and is achieved through a plan ● Example: Risk of high staff turnover (see next slide)
  • 24. * Background (continued) ● Meet with current staff to determine causes for turnover (e.g., poor working conditions, low pay, competitive job market) ● Mitigate those causes that are under our control before the project starts ● Once the project commences, assume turnover will occur and develop techniques to ensure continuity when people leave ● Organize project teams so that information about each development activity is widely dispersed ● Define documentation standards and establish mechanisms to ensure that documents are developed in a timely manner ● Conduct peer reviews of all work (so that more than one person is "up to speed") ● Assign a backup staff member for every critical technologist Strategy for Reducing Staff Turnover
  • 25. * Background (continued) ● During risk monitoring, the project manager monitors factors that may provide an indication of whether a risk is becoming more or less likely ● Risk management and contingency planning assume that mitigation efforts have failed and that the risk has become a reality ● RMMM steps incur additional project cost ● Large projects may have identified 30 – 40 risks ● Risk is not limited to the software project itself ● Risks can occur after the software has been delivered to the user
  • 26. * Background (continued) ● Software safety and hazard analysis ● These are software quality assurance activities that focus on the identification and assessment of potential hazards that may affect software negatively and cause an entire system to fail ● If hazards can be identified early in the software process, software design features can be specified that will either eliminate or control potential hazards
  • 27. * The RMMM Plan ● The RMMM plan may be a part of the software development plan. ● Once RMMM has been documented and the project has begun, the risk mitigation, and monitoring steps begin ● Risk mitigation is a problem avoidance activity ● Risk monitoring is a project tracking activity ● Risk monitoring has three objectives ● To assess whether predicted risks do, in fact, occur ● To ensure that risk aversion steps defined for the risk are being properly applied ● To collect information that can be used for future risk analysis ● The findings from risk monitoring may allow the project manager to ascertain what risks caused which problems throughout the project
  • 28. * Seven Principles of Risk Management ● Maintain a global perspective ● View software risks within the context of a system and the business problem that is is intended to solve ● Take a forward-looking view ● Think about risks that may arise in the future; establish contingency plans ● Encourage open communication ● Encourage all stakeholders and users to point out risks at any time ● Integrate risk management ● Integrate the consideration of risk into the software process ● Emphasize a continuous process of risk management ● Modify identified risks as more becomes known and add new risks as better insight is achieved ● Develop a shared product vision ● A shared vision by all stakeholders facilitates better risk identification and assessment ● Encourage teamwork when managing risk ● Pool the skills and experience of all stakeholders when conducting risk management activities
  • 29. * Summary ● Whenever much is riding on a software project, common sense dictates risk analysis ● Yet, most project managers do it informally and superficially, if at all ● However, the time spent in risk management results in ● Less upheaval during the project ● A greater ability to track and control a project ● The confidence that comes with planning for problems before they occur ● Risk management can absorb a significant amount of the project planning effort…but the effort is worth it ☺
