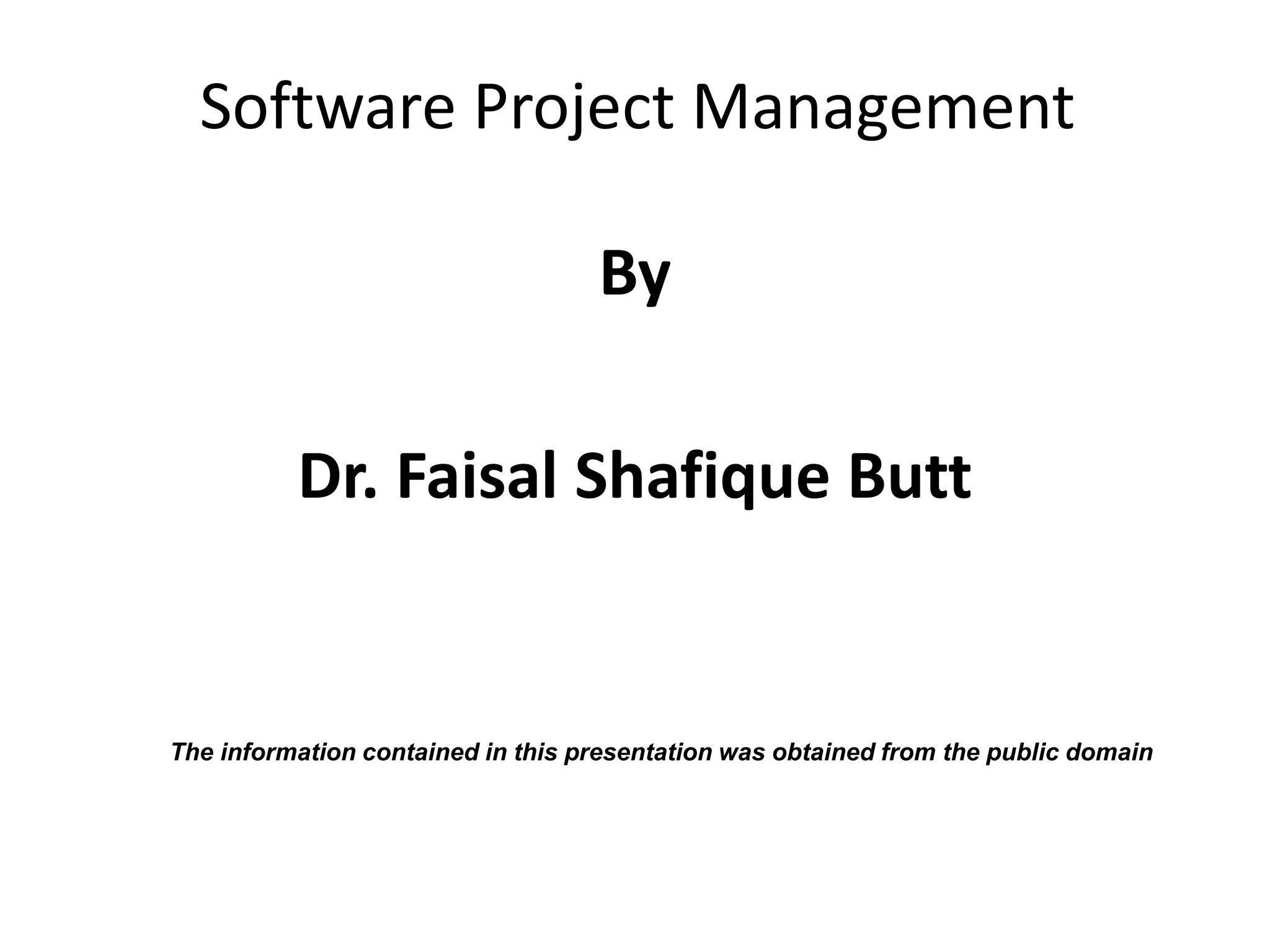

Software Project Management
By
Dr. Faisal Shafique Butt
The information contained in this presentation was obtained from the public domain
Topic of the Day
Software Risk Management
If you don't invest in risk
management, it doesn't matter what
business you're in, it's a risky
business.
Gary Cohn

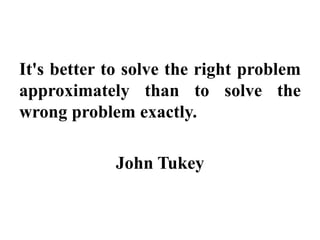

It's better to solve the right problem
approximately than to solve the
wrong problem exactly.
John Tukey
When you gamble with safety, you
bet your life.

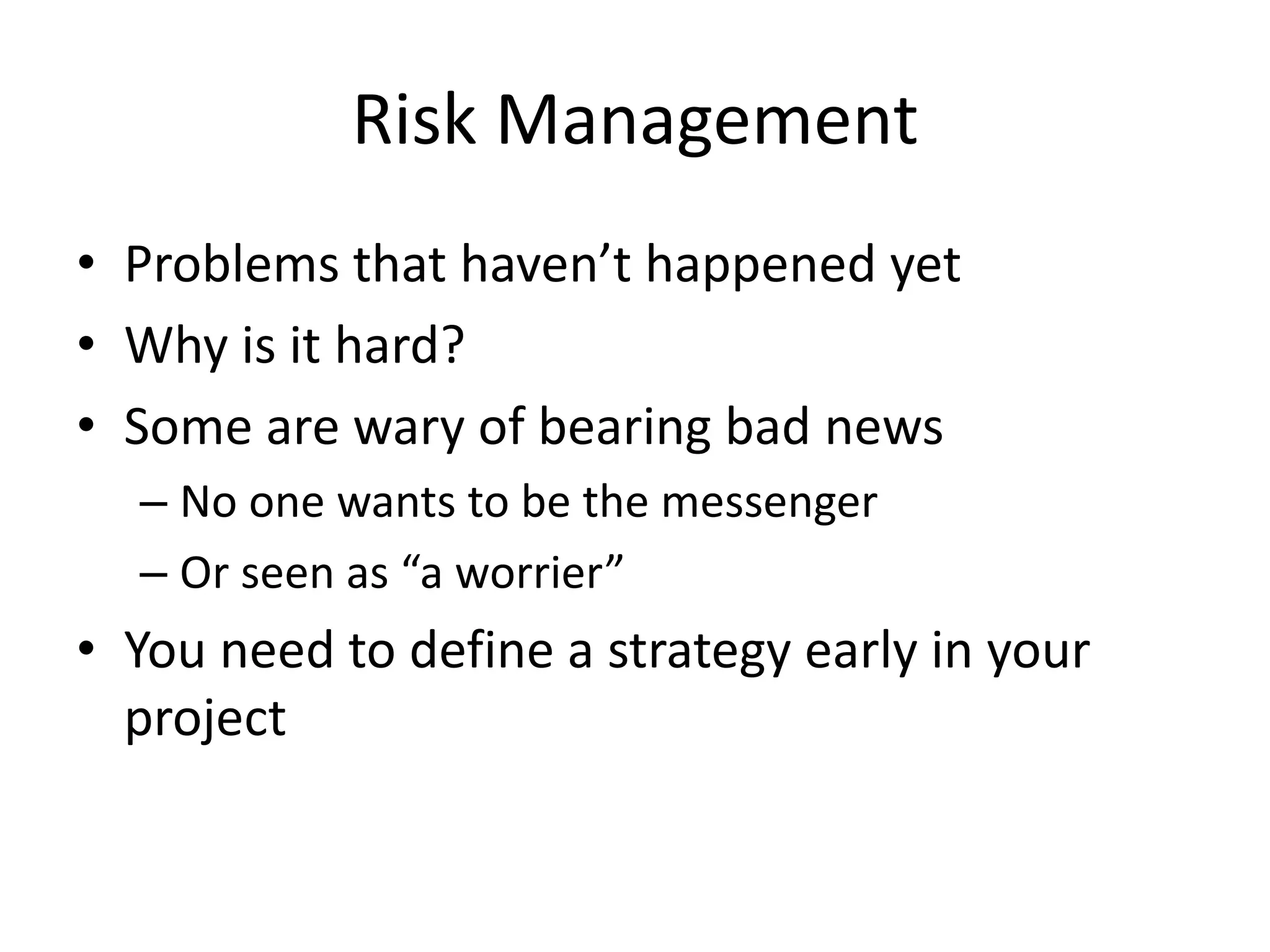

Risk Management
• Problems that haven’t happened yet
• Why is it hard?
• Some are wary of bearing bad news
– No one wants to be the messenger
– Or seen as “a worrier”
• You need to define a strategy early in your
project

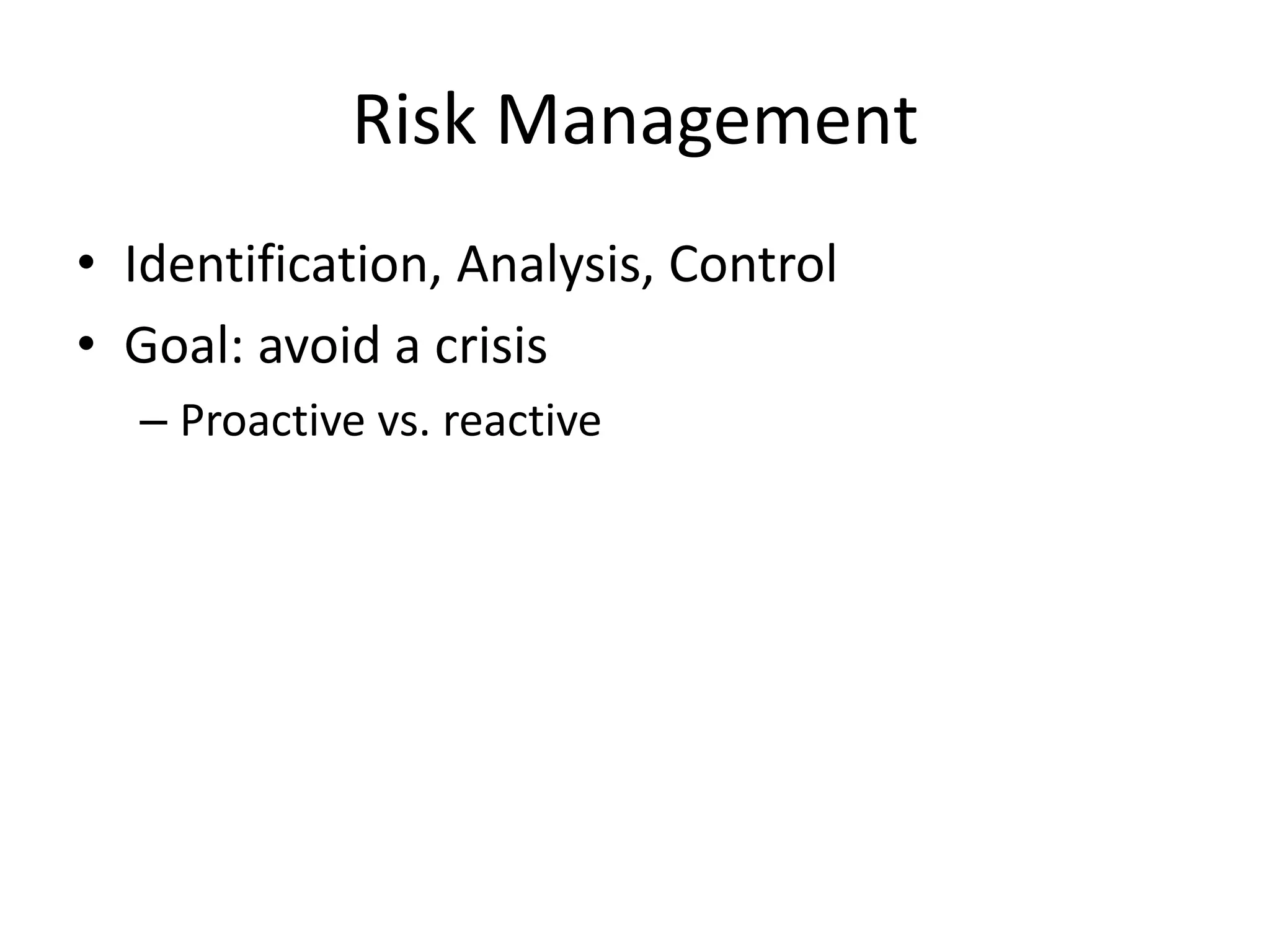

Risk Management
• Identification, Analysis, Control
• Goal: avoid a crisis
– Proactive vs. reactive

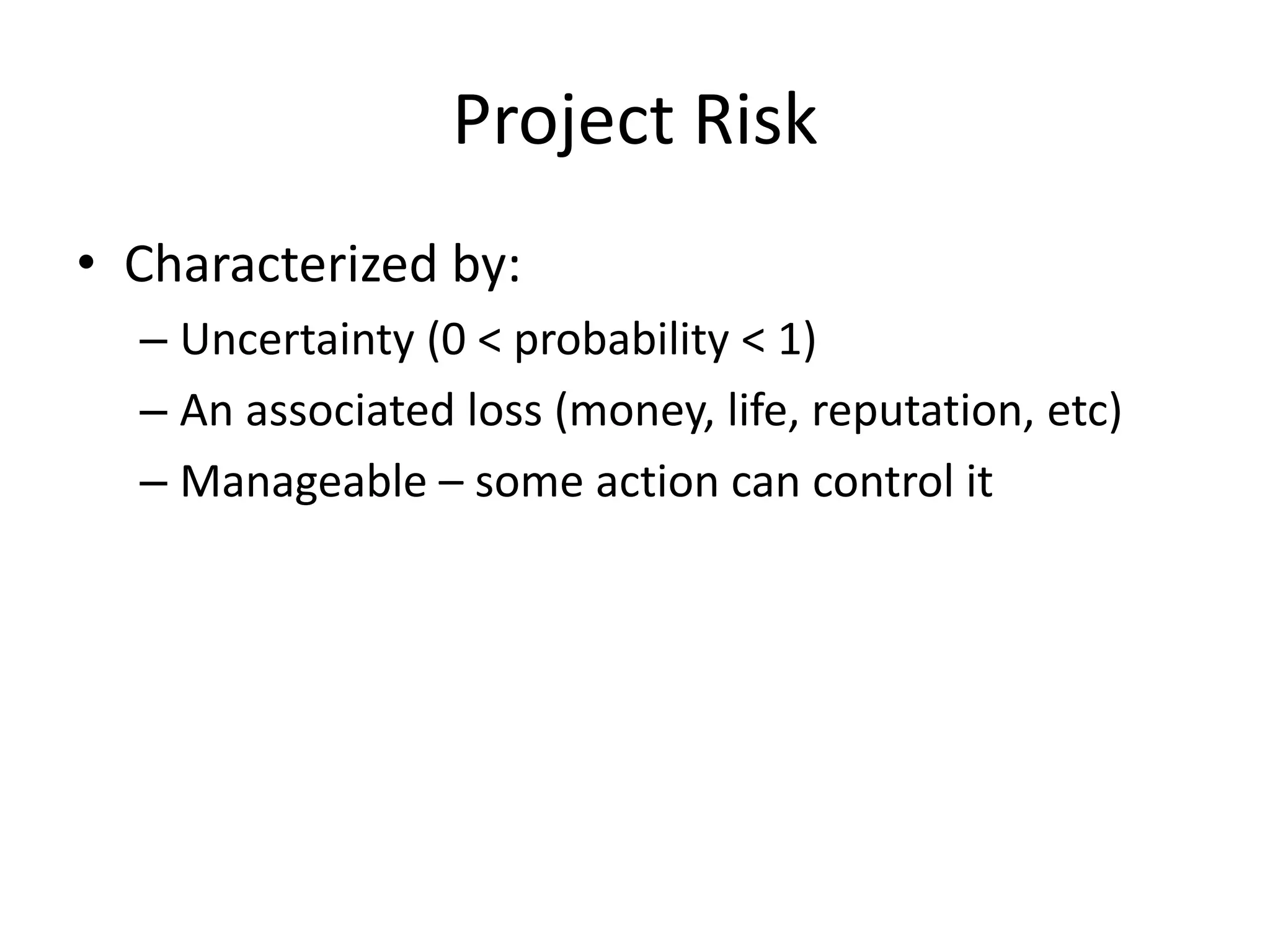

Project Risk
• Characterized by:
– Uncertainty (0 < probability < 1)
– An associated loss (money, life, reputation, etc)
– Manageable – some action can control it
Types of Risks
• Schedule Risks
• Schedule compression (customer, marketing, etc.)
• Cost Risks
• Unreasonable budgets
• Requirements Risks
• Incorrect
• Incomplete
• Unclear or inconsistent
• Volatile

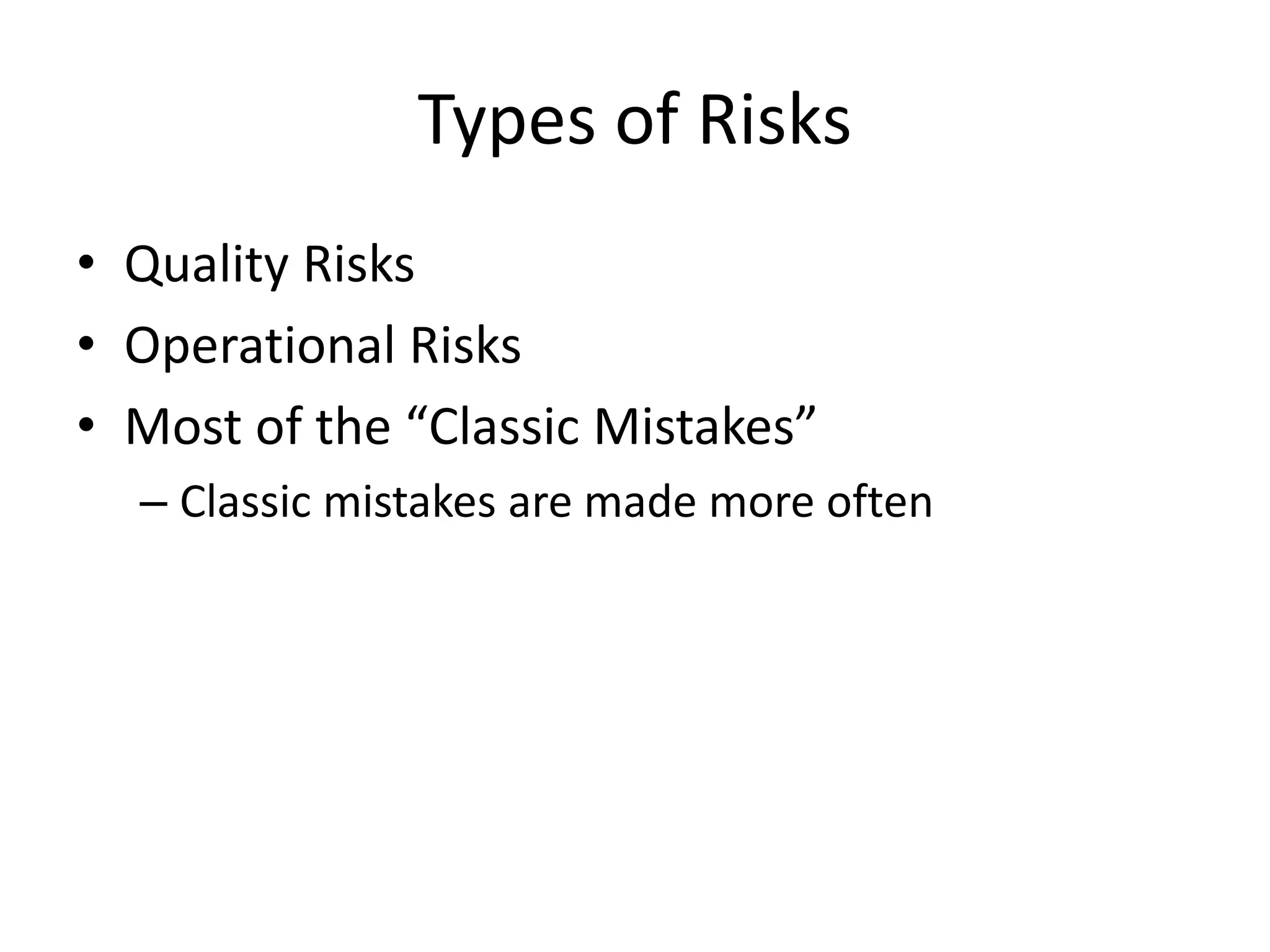

Types of Risks
• Quality Risks
• Operational Risks
• Most of the “Classic Mistakes”
– Classic mistakes are made more often

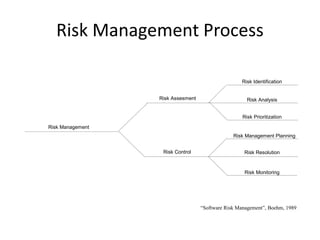

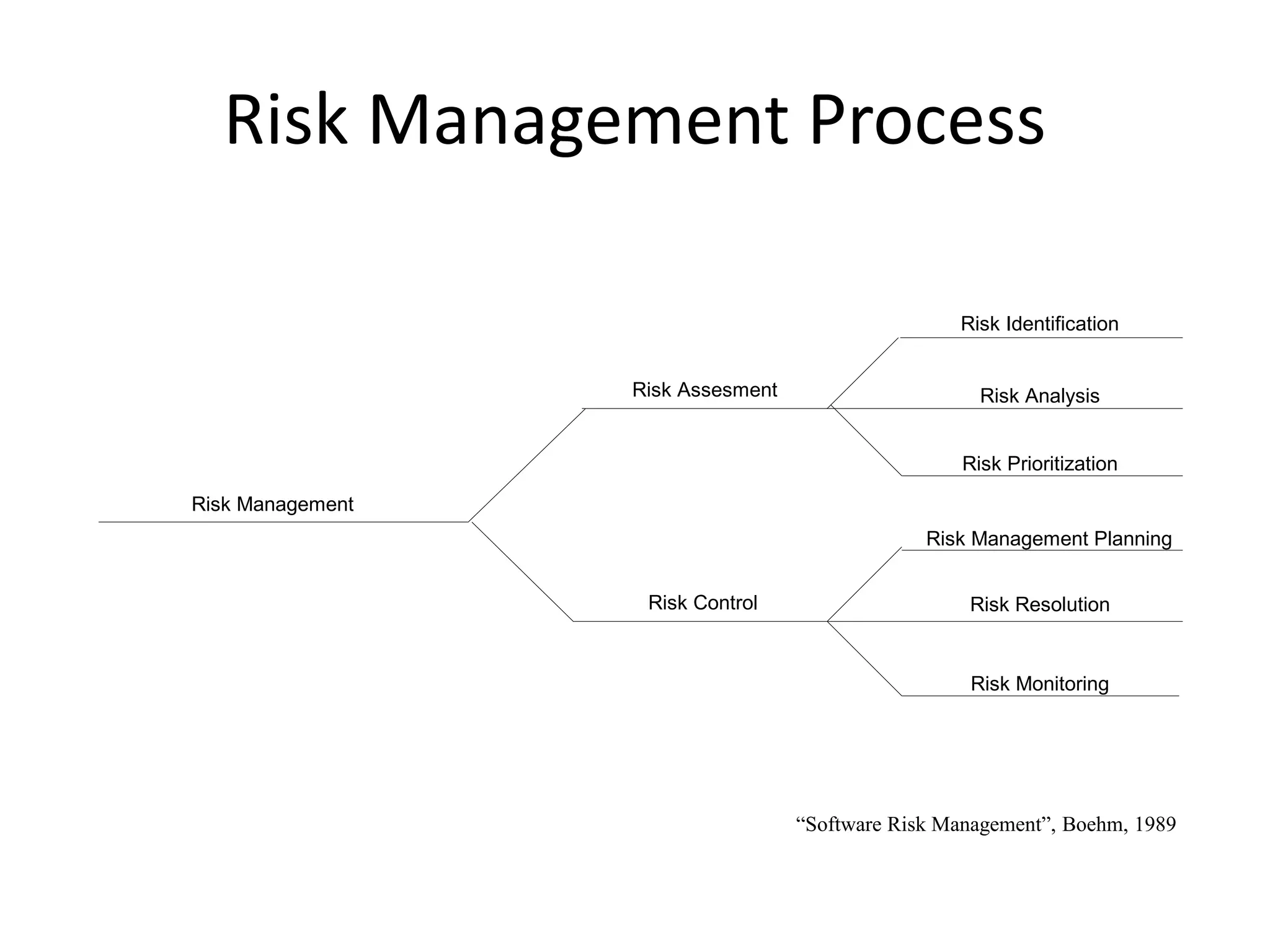

Risk Management Process
Risk Management
Risk Assesment
Risk Control
Risk Identification
Risk Analysis
Risk Prioritization
Risk Management Planning
Risk Resolution
Risk Monitoring
“Software Risk Management”, Boehm, 1989
Risk Identification
• Get your team involved in this process
– Don’t go it alone
• Produce a list of risks with potential to disrupt
your project’s schedule
• Use a checklist or similar source to brainstorm
possible risks

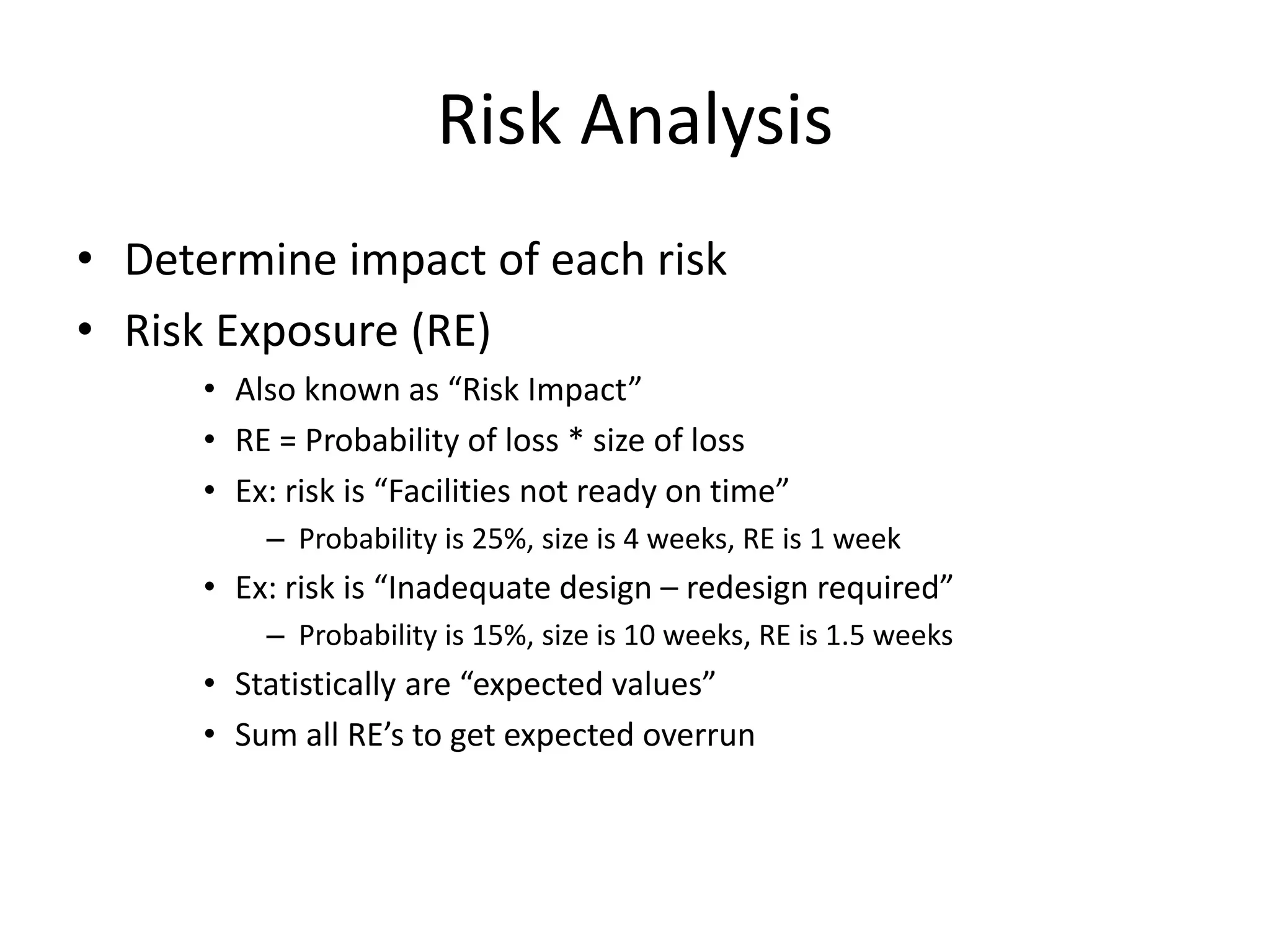

Risk Analysis
• Determine impact of each risk
• Risk Exposure (RE)
• Also known as “Risk Impact”
• RE = Probability of loss * size of loss
• Ex: risk is “Facilities not ready on time”
– Probability is 25%, size is 4 weeks, RE is 1 week
• Ex: risk is “Inadequate design – redesign required”
– Probability is 15%, size is 10 weeks, RE is 1.5 weeks
• Statistically are “expected values”
• Sum all RE’s to get expected overrun
Risk Prioritization
• Often want larger-loss risks higher
– Or higher probability items
• Possibly group ‘related risks’
• Helps identify which risks to ignore
– Those at the bottom

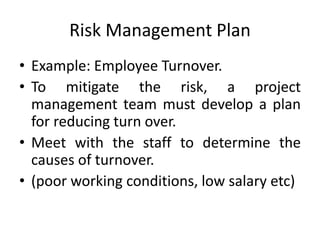

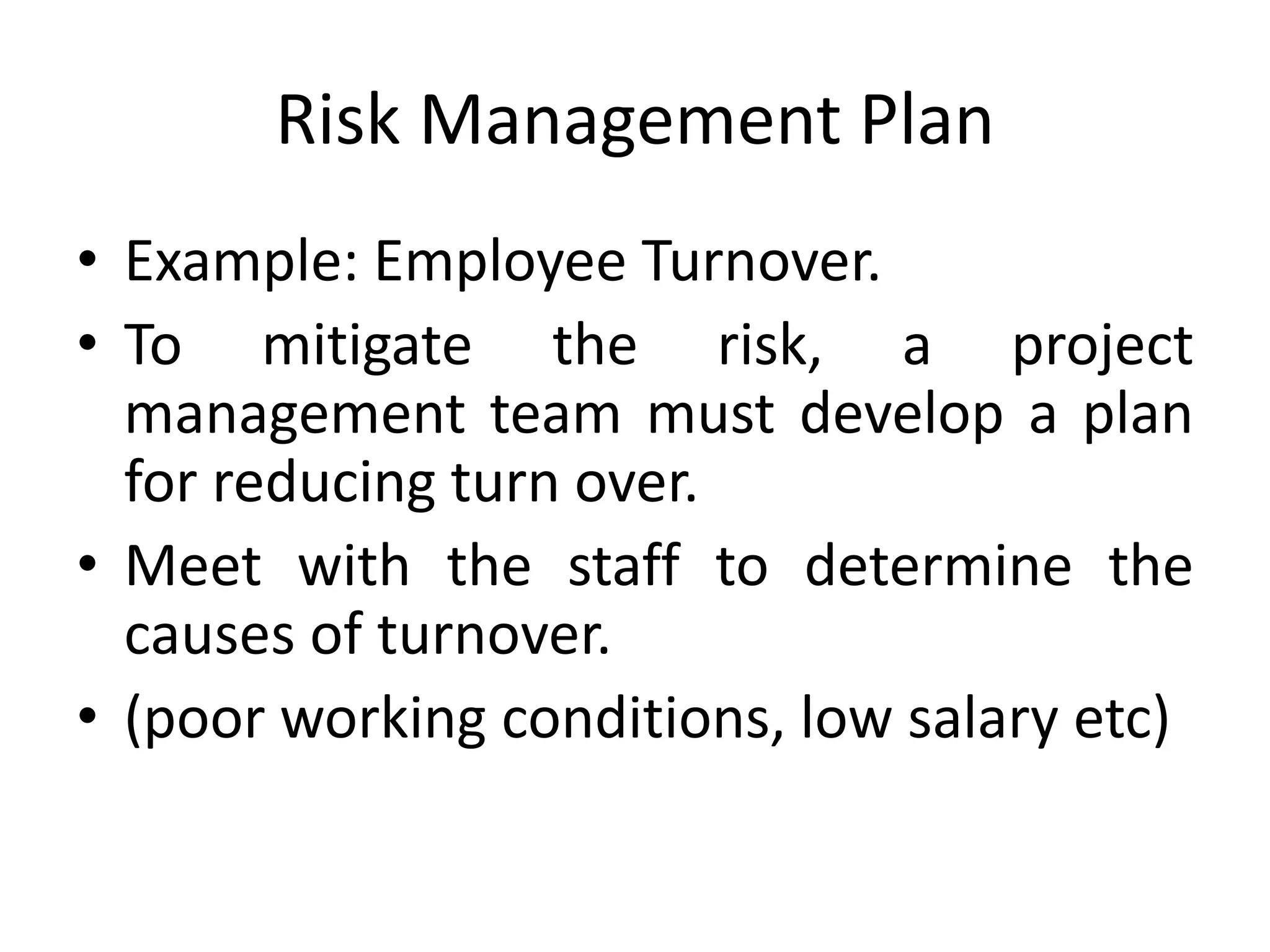

Risk Management Plan
• Example: Employee Turnover.
• To mitigate the risk, a project
management team must develop a plan
for reducing turn over.
• Meet with the staff to determine the
causes of turnover.
• (poor working conditions, low salary etc)

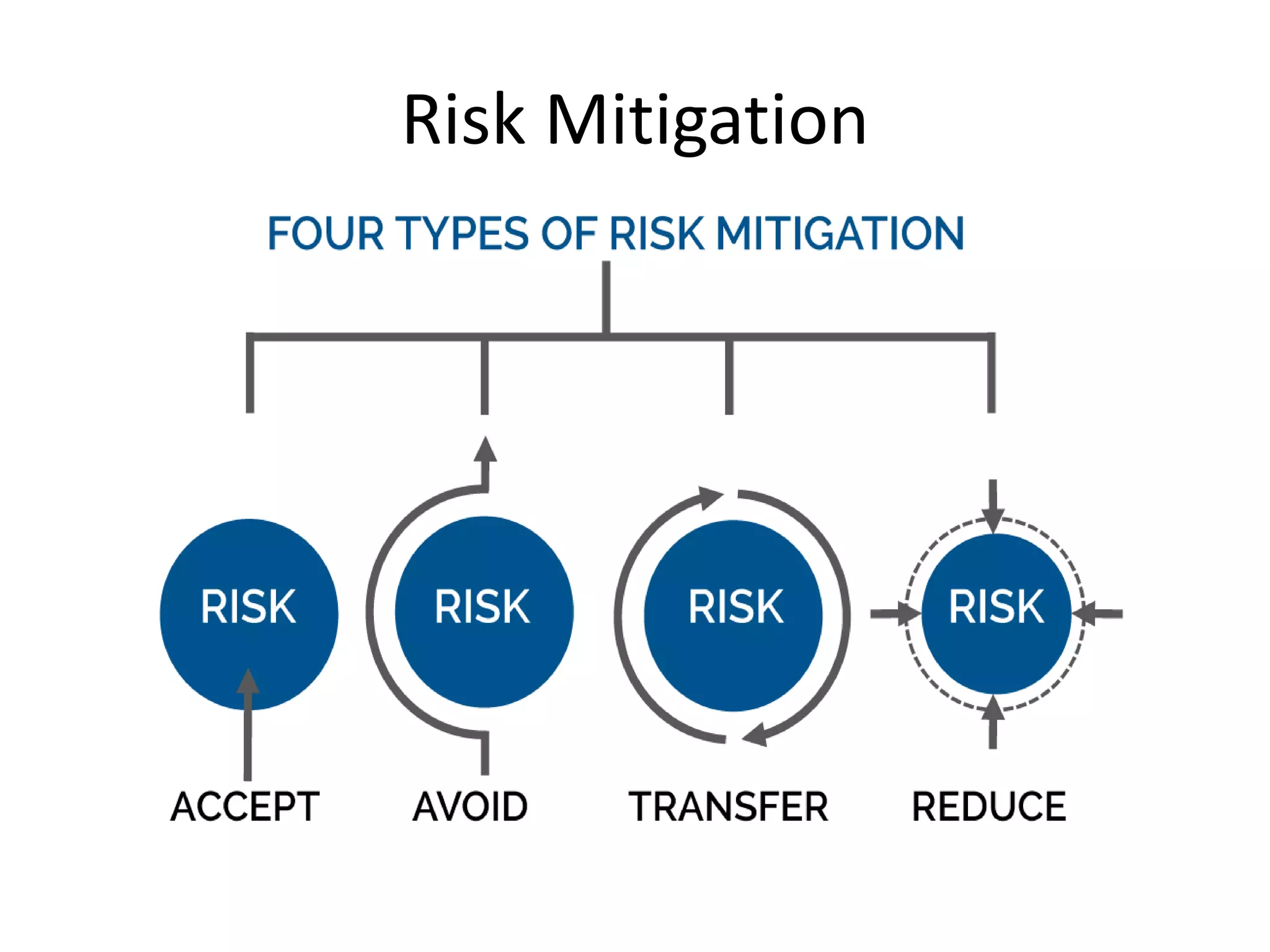

Risk Mitigation
Risk Mitigation

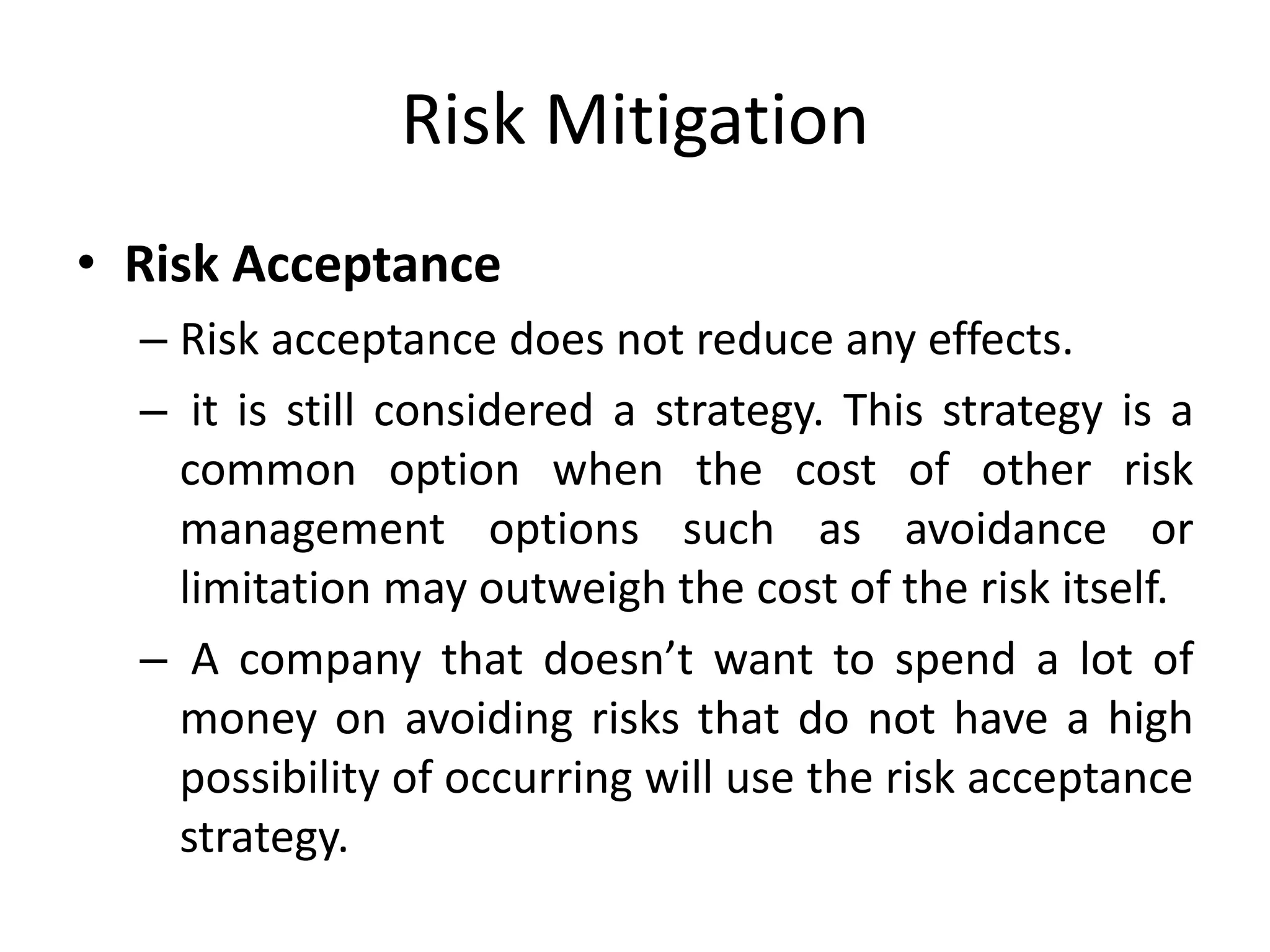

• Risk Acceptance
– Risk acceptance does not reduce any effects.
– it is still considered a strategy. This strategy is a
common option when the cost of other risk
management options such as avoidance or
limitation may outweigh the cost of the risk itself.
– A company that doesn’t want to spend a lot of
money on avoiding risks that do not have a high
possibility of occurring will use the risk acceptance
strategy.
Risk Mitigation
• Risk Avoidance
– Risk avoidance is the opposite of risk acceptance.
It is the action that avoids any exposure to the risk
whatsoever.
– It’s important to note that risk avoidance is usually
the most expensive of all risk mitigation options.
Risk Mitigation

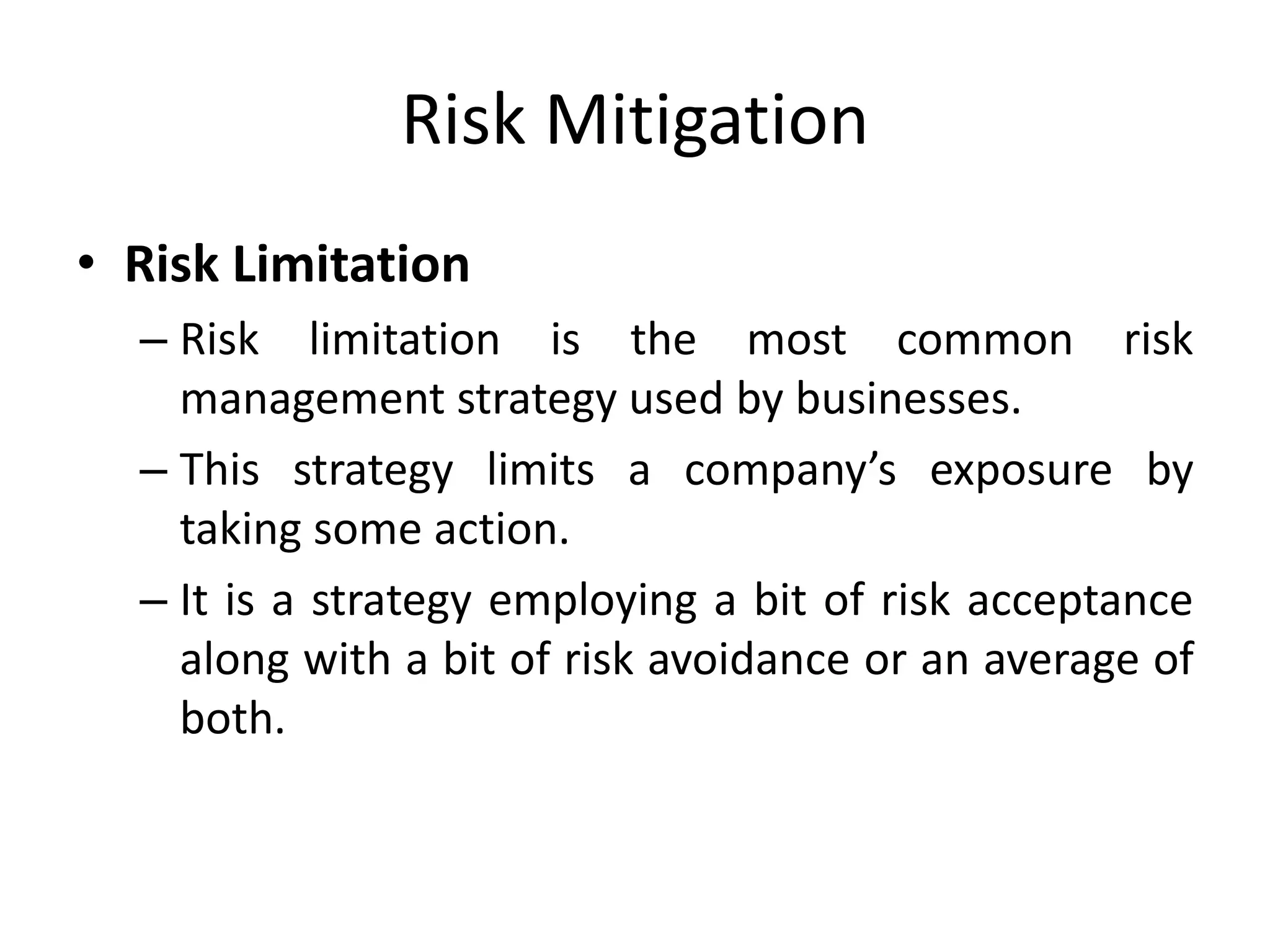

• Risk Limitation
– Risk limitation is the most common risk
management strategy used by businesses.
– This strategy limits a company’s exposure by
taking some action.
– It is a strategy employing a bit of risk acceptance
along with a bit of risk avoidance or an average of
both.
Risk Mitigation

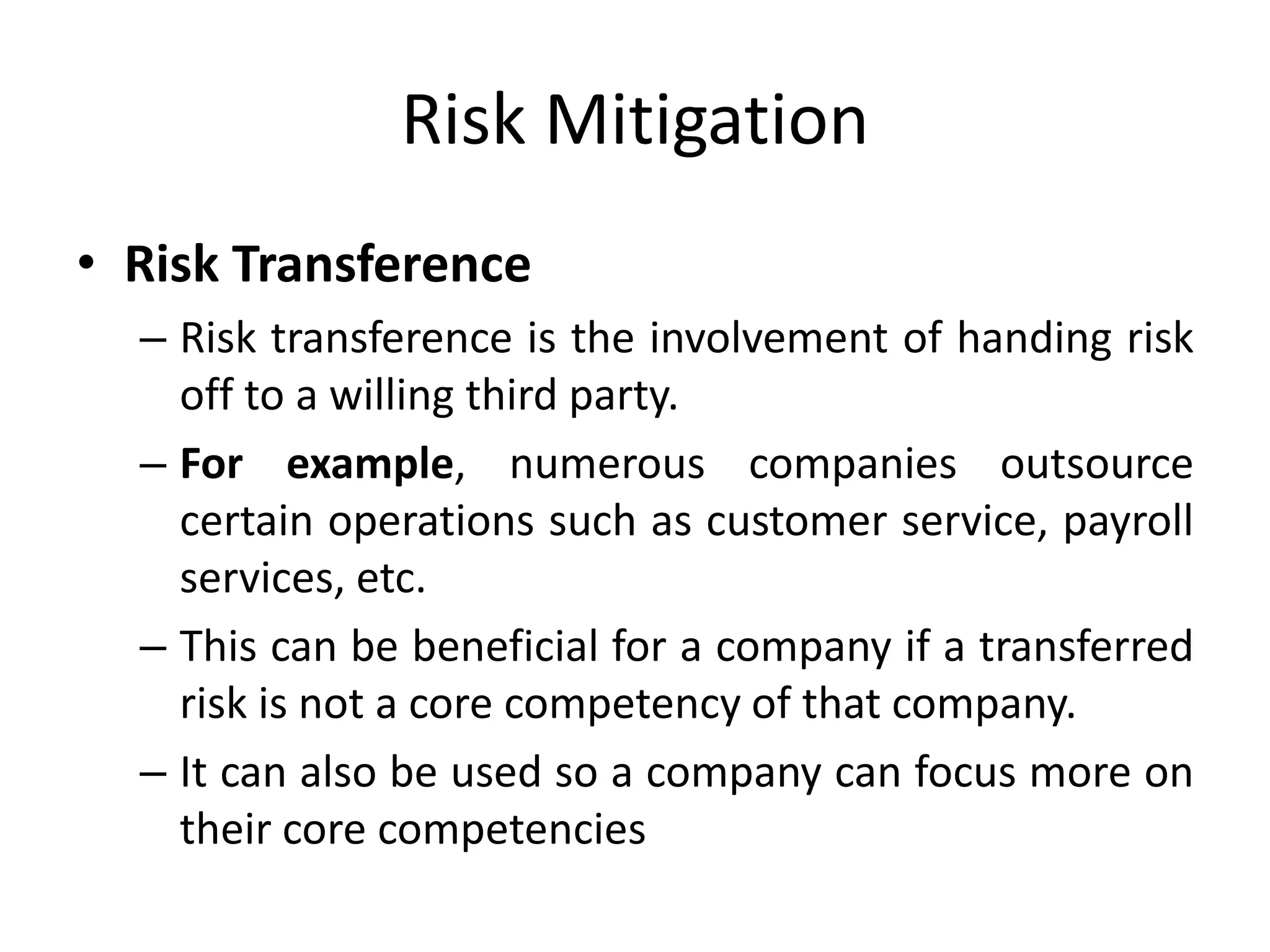

• Risk Transference
– Risk transference is the involvement of handing risk
off to a willing third party.
– For example, numerous companies outsource
certain operations such as customer service, payroll
services, etc.
– This can be beneficial for a company if a transferred
risk is not a core competency of that company.
– It can also be used so a company can focus more on
their core competencies

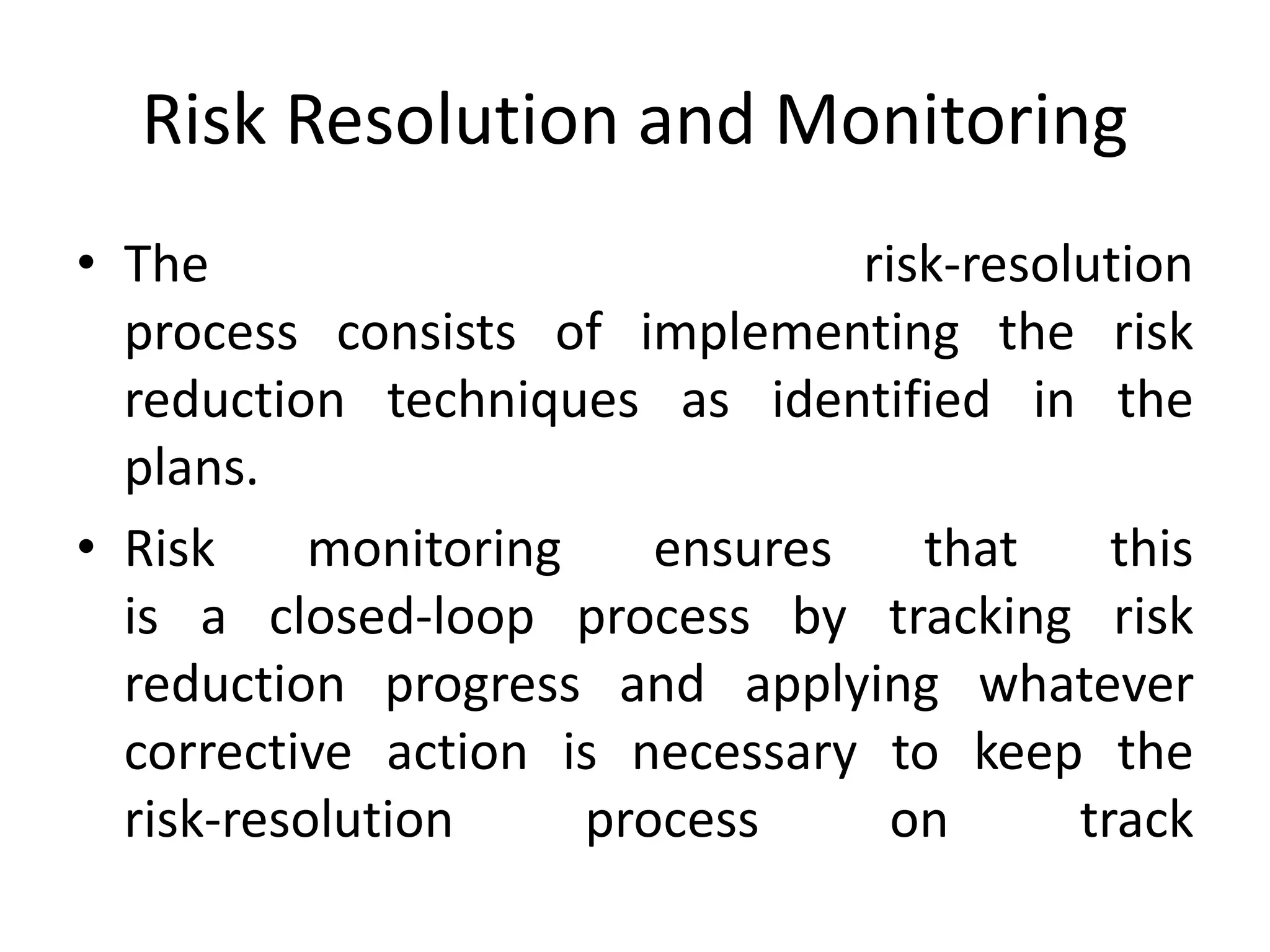

Risk Resolution and Monitoring
• The risk-resolution
process consists of implementing the risk
reduction techniques as identified in the
plans.
• Risk monitoring ensures that this
is a closed-loop process by tracking risk
reduction progress and applying whatever
corrective action is necessary to keep the
risk-resolution process on track

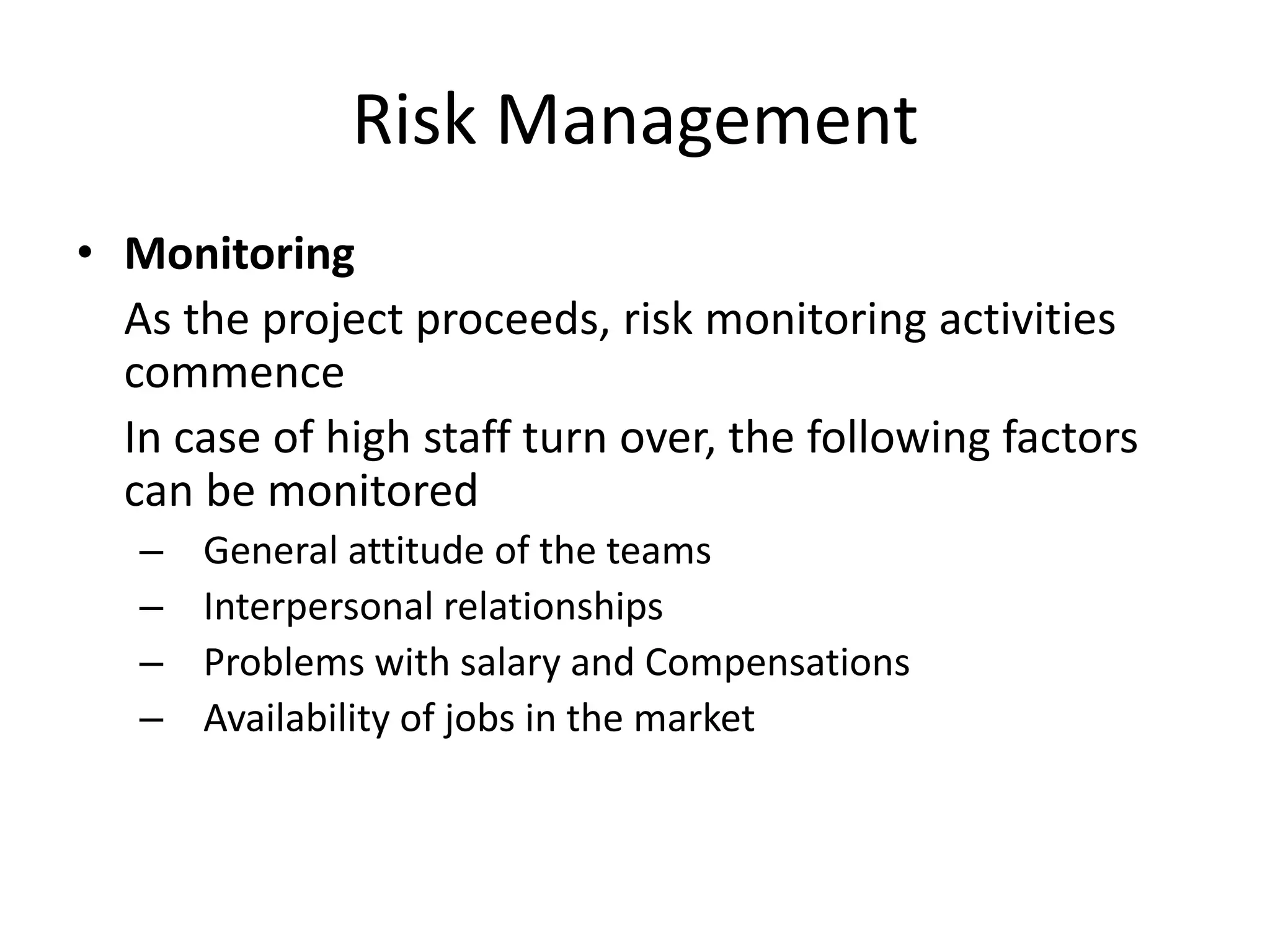

Risk Management
• Monitoring
As the project proceeds, risk monitoring activities
commence
In case of high staff turn over, the following factors
can be monitored
– General attitude of the teams
– Interpersonal relationships
– Problems with salary and Compensations
– Availability of jobs in the market

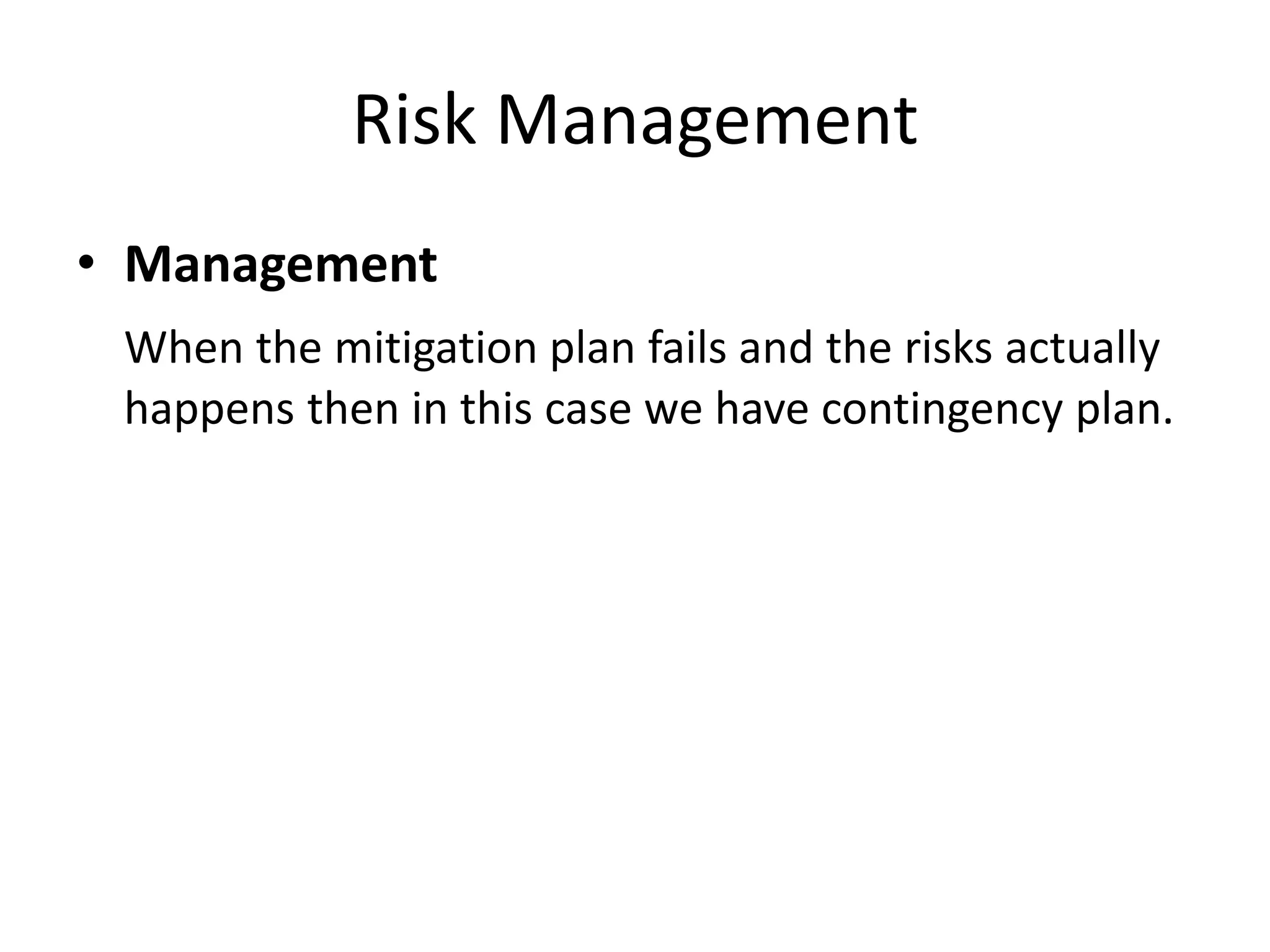

Risk Management
• Management
When the mitigation plan fails and the risks actually
happens then in this case we have contingency plan.
Risk Register
Risk ID Description Probability Project
Phase
Response Response
Plan
Contingency
Plan
Owner

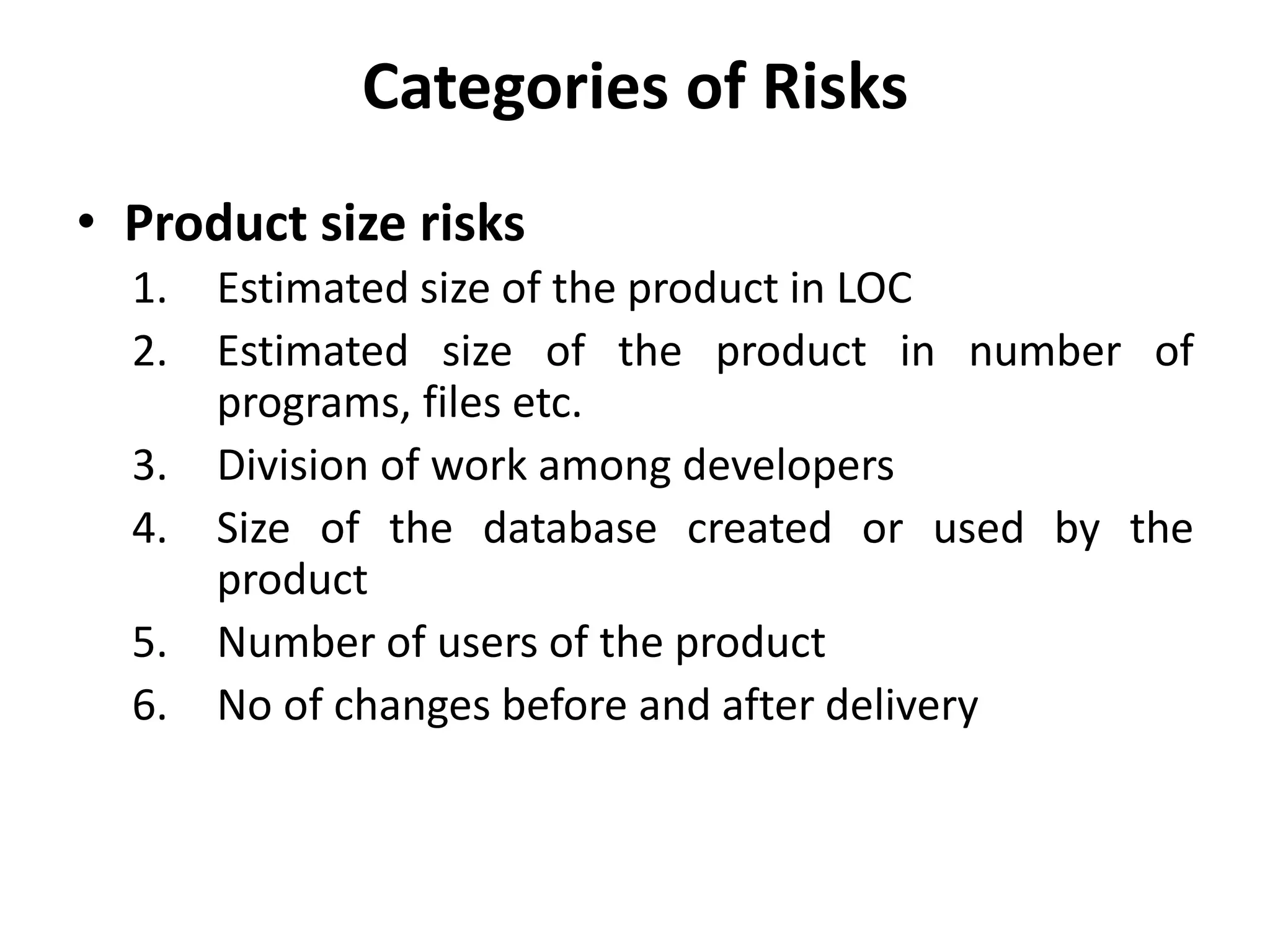

Categories of Risks
• Product size risks
1. Estimated size of the product in LOC
2. Estimated size of the product in number of
programs, files etc.
3. Division of work among developers
4. Size of the database created or used by the
product
5. Number of users of the product
6. No of changes before and after delivery
Categories of Risks
• Business impact risks
1. Effect of this product on company’s revenue
2. Reasonableness of the delivery date
3. Number of users who will use this product
4. Govt. constraint on the product
5. Costs associated with late delivery
Categories of Risks

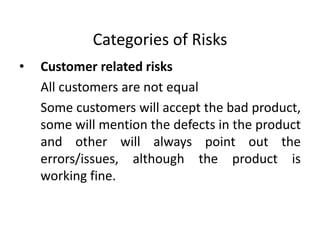

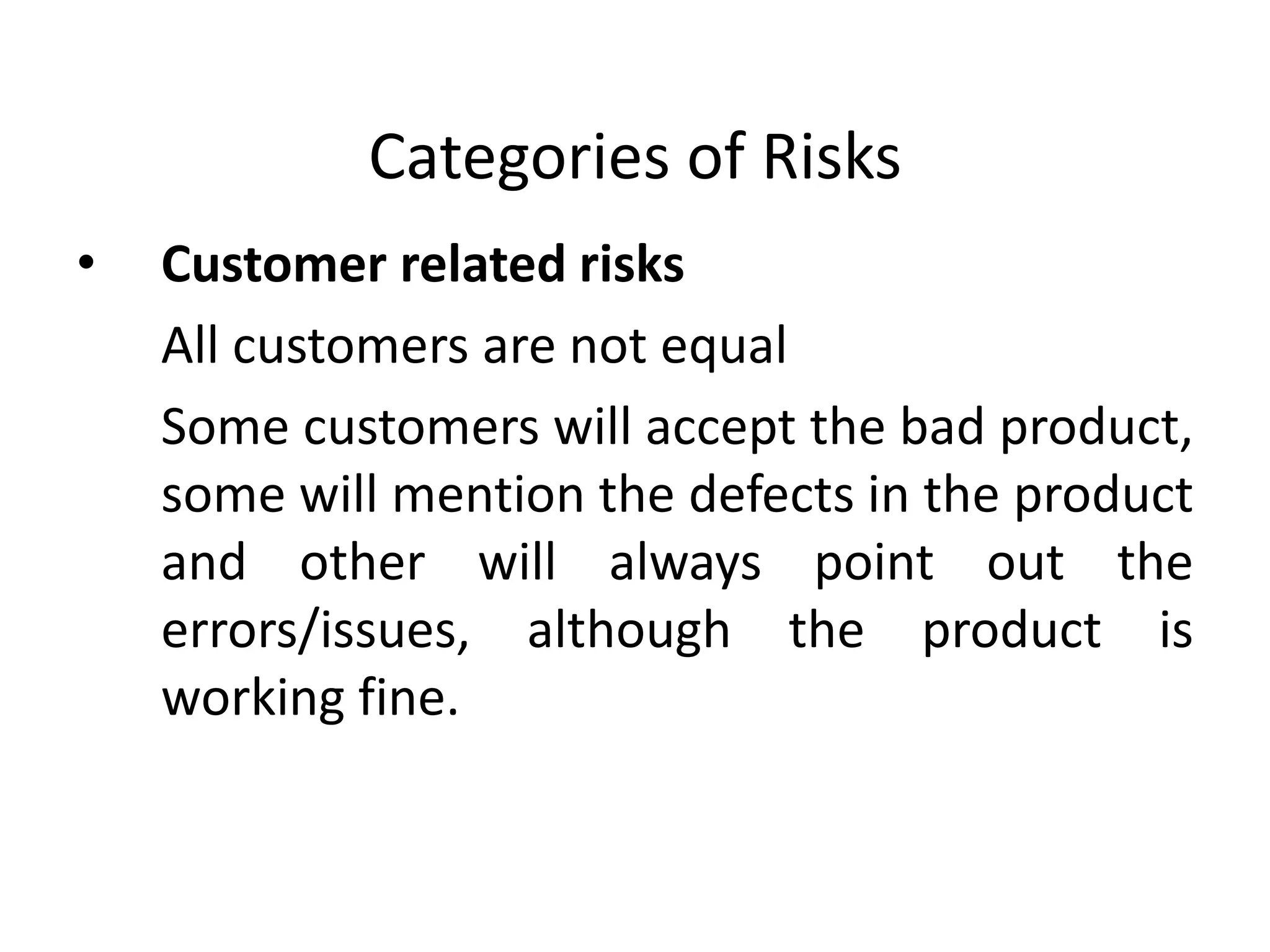

• Customer related risks
All customers are not equal
Some customers will accept the bad product,
some will mention the defects in the product
and other will always point out the
errors/issues, although the product is
working fine.

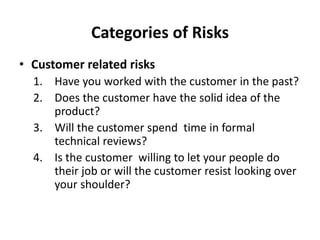

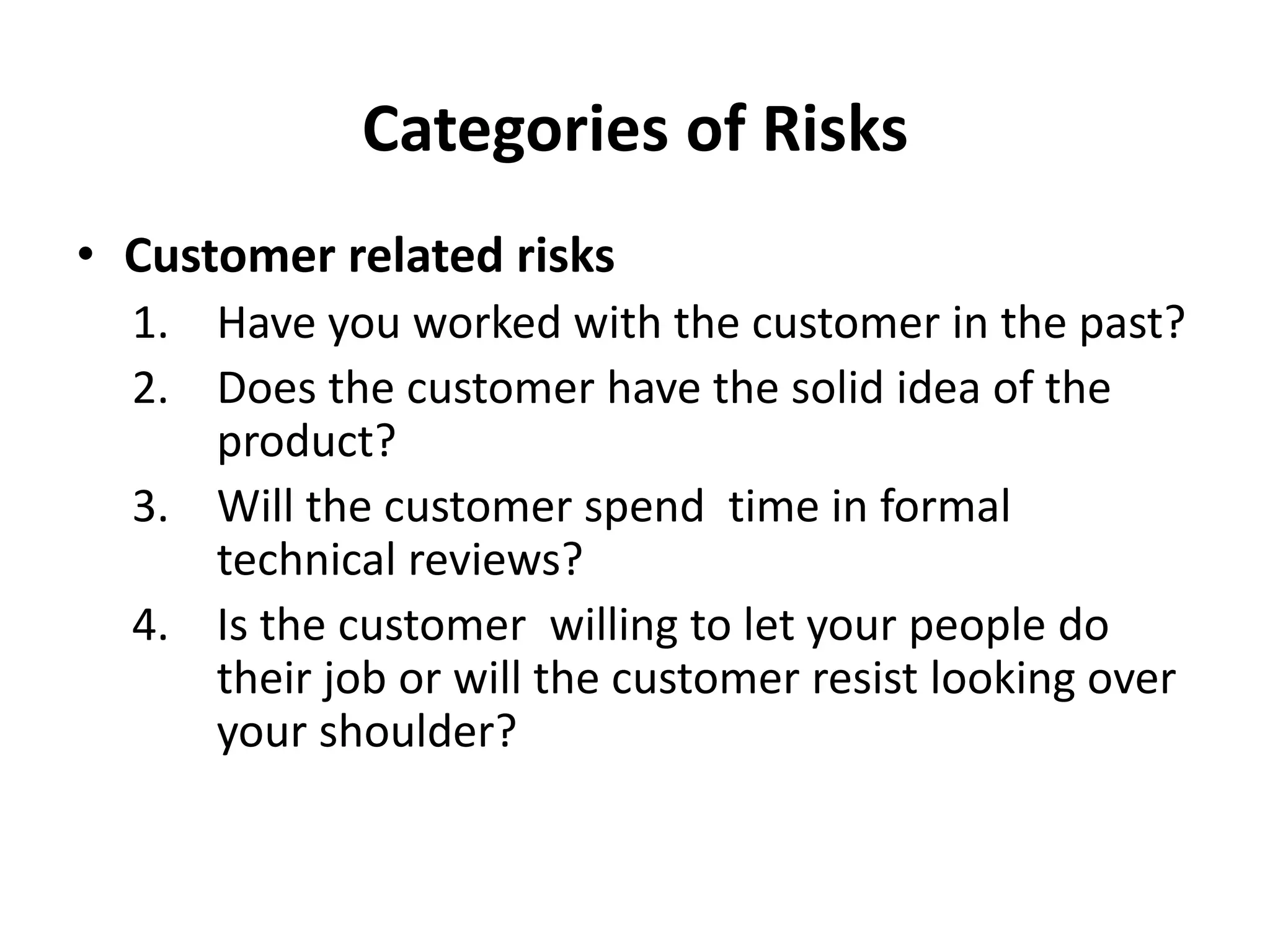

Categories of Risks
• Customer related risks
1. Have you worked with the customer in the past?
2. Does the customer have the solid idea of the
product?
3. Will the customer spend time in formal
technical reviews?
4. Is the customer willing to let your people do
their job or will the customer resist looking over
your shoulder?
Categories of Risks

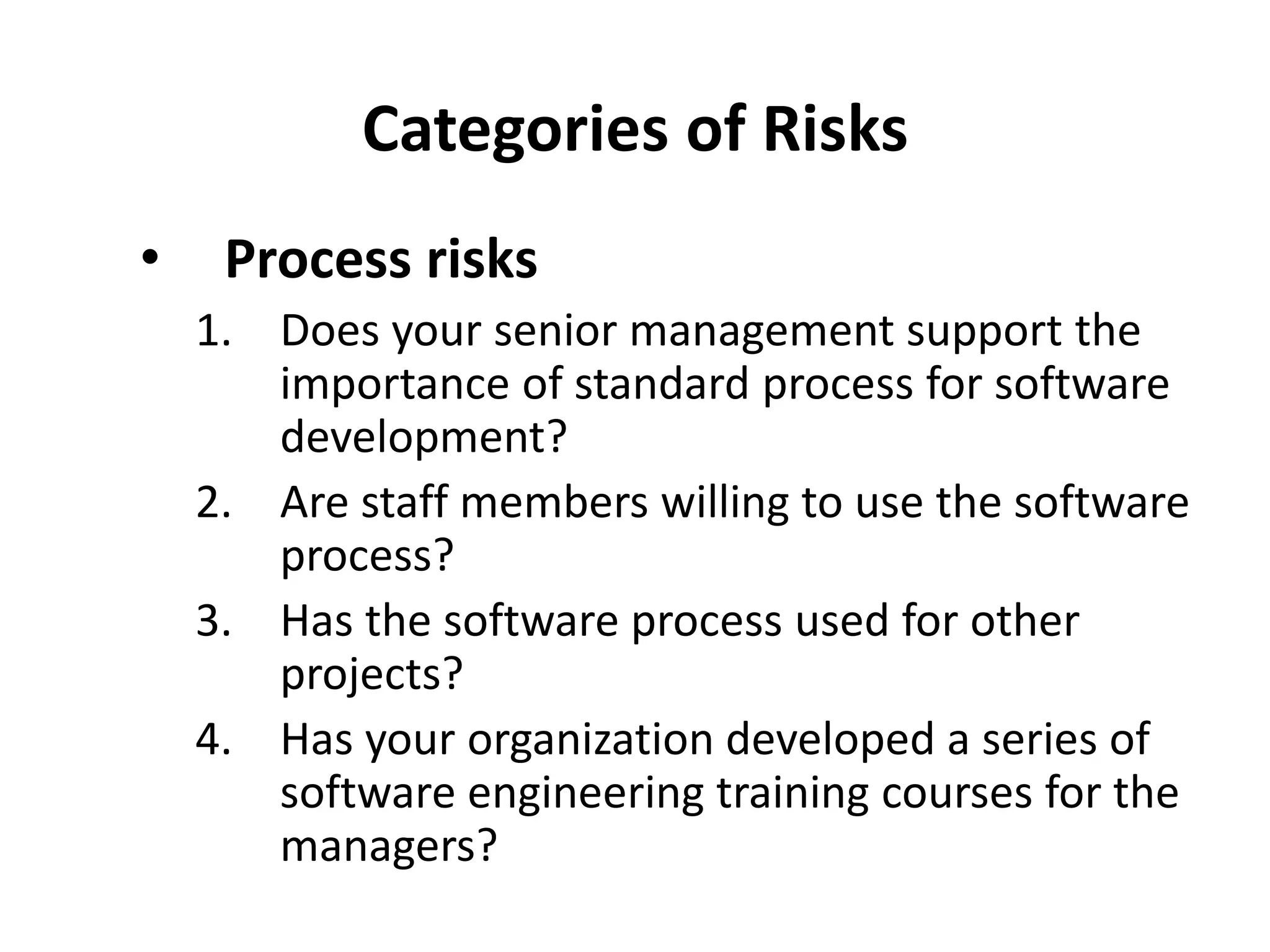

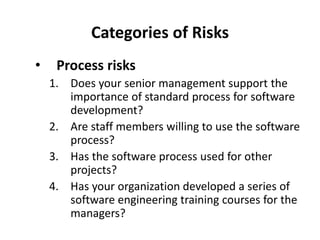

• Process risks
1. Does your senior management support the
importance of standard process for software
development?
2. Are staff members willing to use the software
process?
3. Has the software process used for other
projects?
4. Has your organization developed a series of
software engineering training courses for the
managers?
Categories of Risks
5. Documentation?
6. Are formal technical reviews after
each phase in the organization?
7. Are we working according to
Software Engineering standards?
Categories of Risks

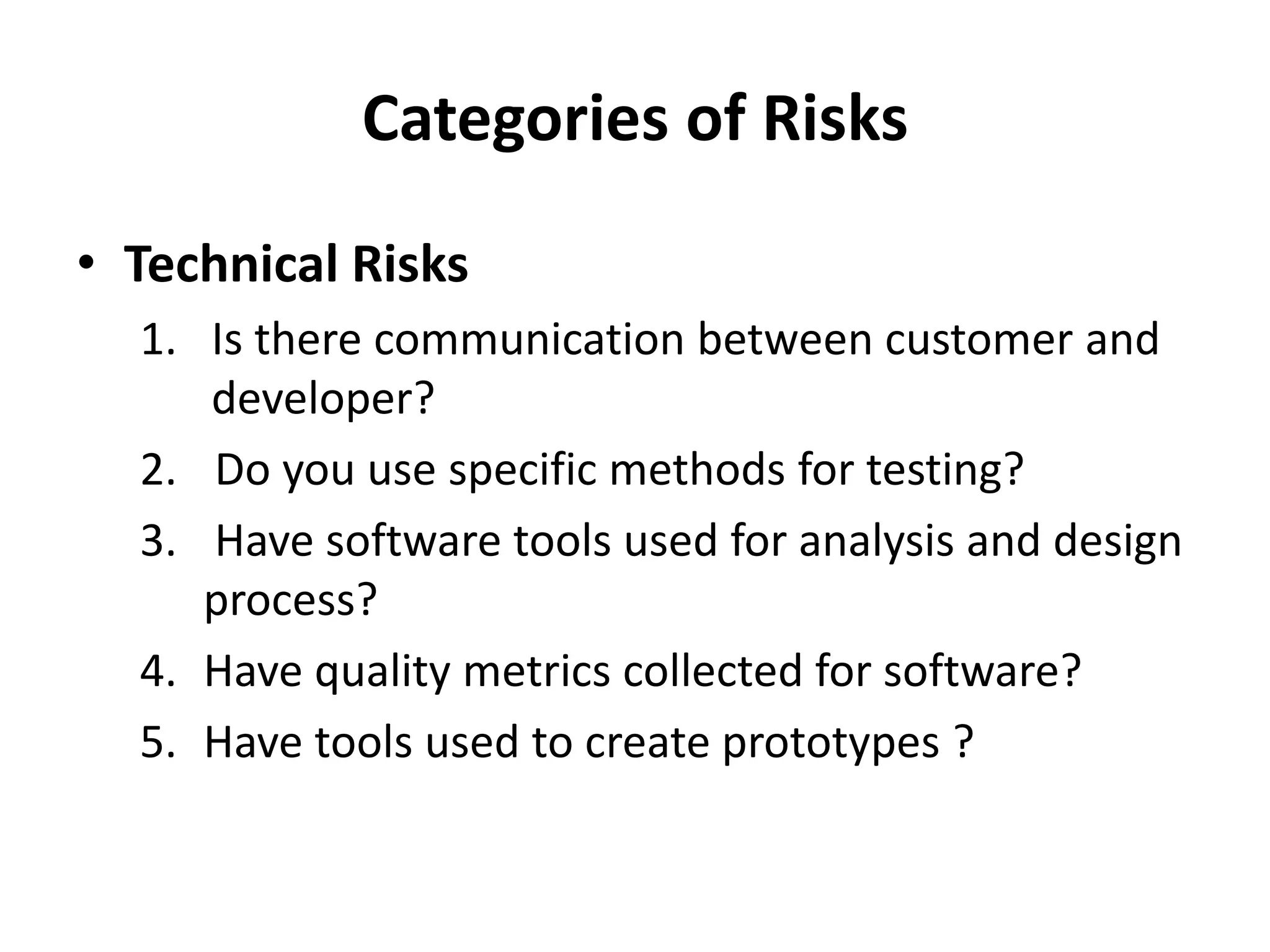

• Technical Risks
1. Is there communication between customer and
developer?
2. Do you use specific methods for testing?
3. Have software tools used for analysis and design
process?
4. Have quality metrics collected for software?
5. Have tools used to create prototypes ?
Categories of Risks

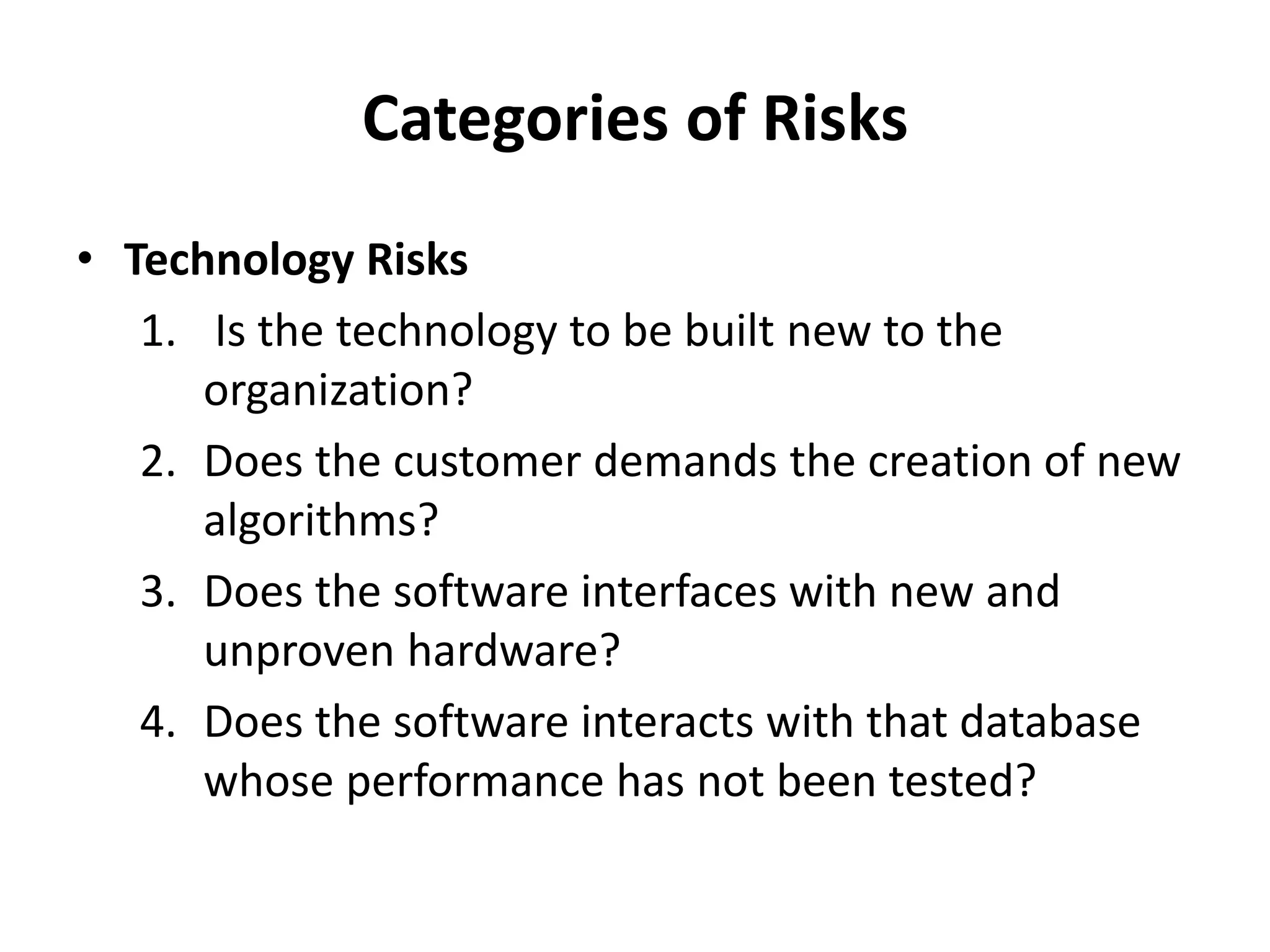

• Technology Risks
1. Is the technology to be built new to the
organization?
2. Does the customer demands the creation of new
algorithms?
3. Does the software interfaces with new and
unproven hardware?
4. Does the software interacts with that database
whose performance has not been tested?
Categories of Risks

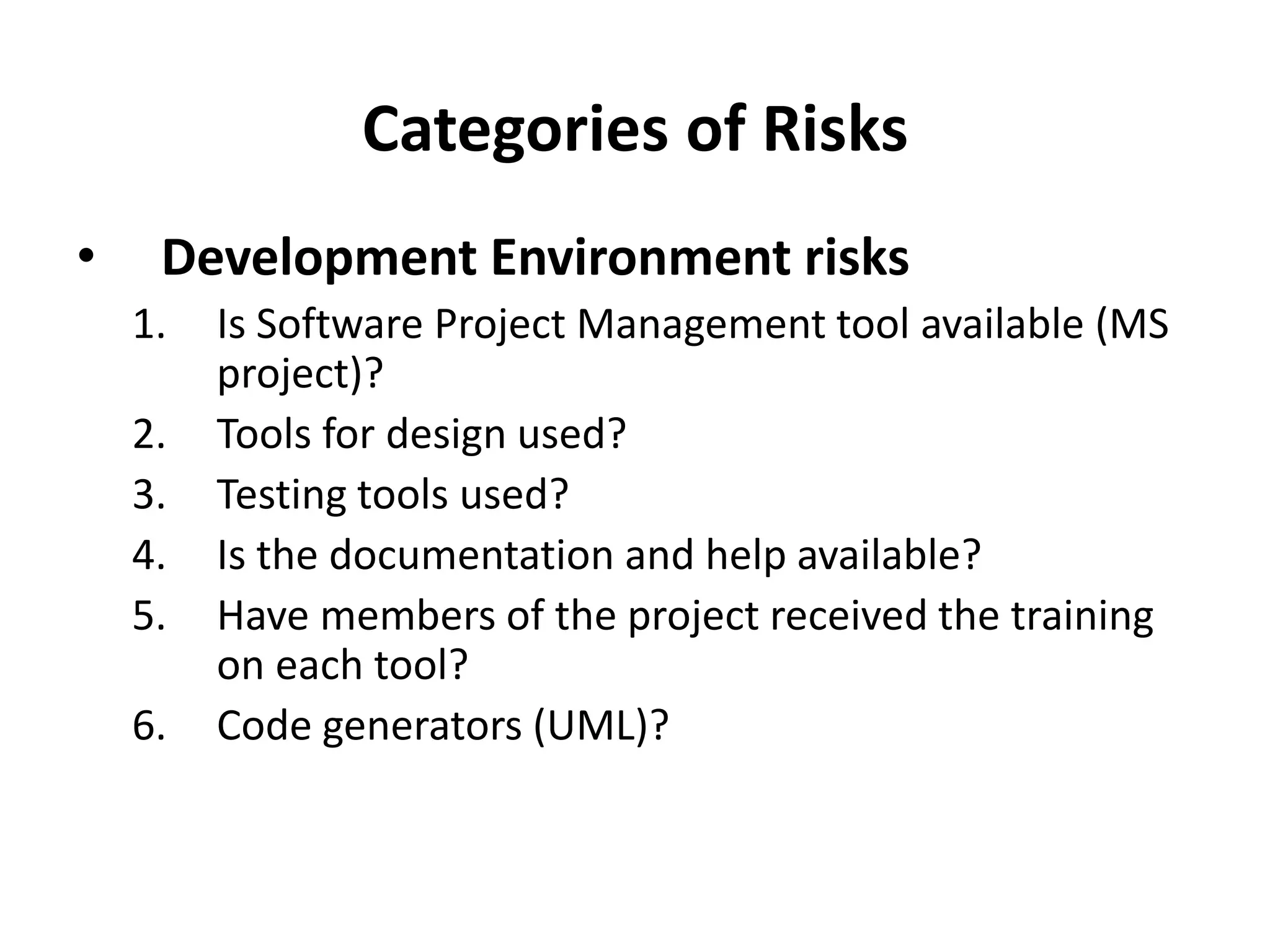

• Development Environment risks
1. Is Software Project Management tool available (MS
project)?
2. Tools for design used?
3. Testing tools used?
4. Is the documentation and help available?
5. Have members of the project received the training
on each tool?
6. Code generators (UML)?
Categories of Risks

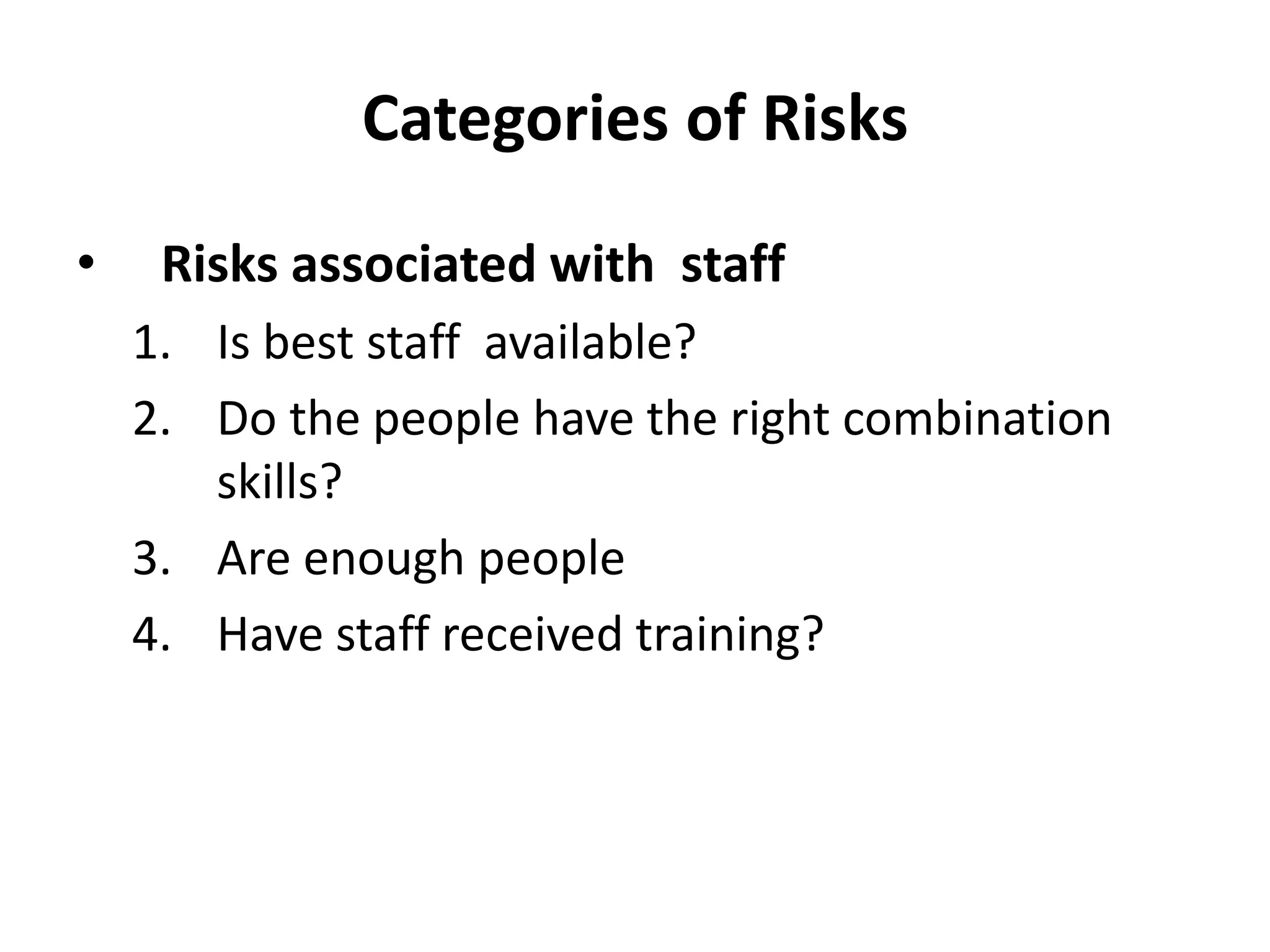

• Risks associated with staff
1. Is best staff available?
2. Do the people have the right combination
skills?
3. Are enough people
4. Have staff received training?
