Oil & Gas Plant Construction
Project Execution Plan
Details of how a Gas & Oil Plant is constructed, and how the progress, safety and quality is monitored and controlled. Also the measures to
ensure that the site is environmentally friendly.
http://www.slideshare.net/DavidHMoloney/oil-gas-plant-construction-project-execution-plan
https://www.youtube.com/watch?v=PiRY0ERoXfI
6avid H Moloney
4th August 2016
Brief Description
The purpose of this presentation is to give an understanding of
the Methods, Plant and Sequence to construct a Gas & Oil Plant
.
This presentation can be used to engage Stakeholders and to get
the Site Teams commitment to the programme. Also can be
used for Induction Training and as a way to capture and share
knowledge.
Project Execution Plan (PEP) details how a project will be
executed, monitored and controlled.
High in Educational Value and easily understood. Recommended
for Continuing Professional Development (CPD)
This Video Presentation is innovative and has many beneficial
uses.
Table of Contents
Contents

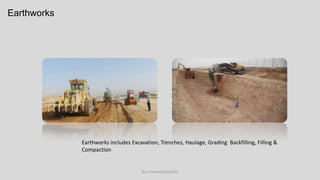

Gas Processing Facility
Earthworks includes Excavation, Trenches, Haulage, Grading Backfilling, Filling & Compaction
Earthworks
Excavate & Load Tipper Trucks

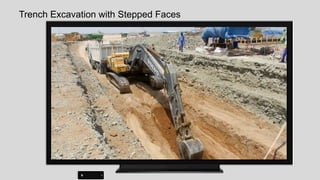

Trench Excavation with Stepped Faces

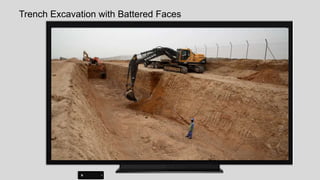

Trench Excavation with Battered Faces

Tipper Trucks Unloading

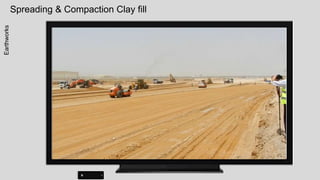

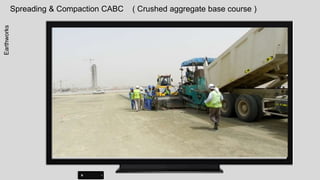

Spreading & Compaction Clay fillEarthworks
Spreading & Compaction Clay fillEarthworks
Backfill TrenchEarthworks
Dozer Pushing ClayEarthworks
Dozer Ripping GroundEarthworks
Excavator with Hydraulic RockbreakerEarthworks

Excavate & Load, Cart, Tip & Return
Brief Description
Cycle Time for 7km haulage distance
using an Excavator 45 tonne weight
and Dumper with a 40 tonne capacity,
the cycle time is 34 minutes
Earthworks
7 minutes
14 minutes
3 minutes
14 minutes 7 km
7 km
CABC ( Crushed aggregate base course )
Earthworks
Mixing Plant
Testing Compaction
Site Trial

Mixing CABCEarthworks

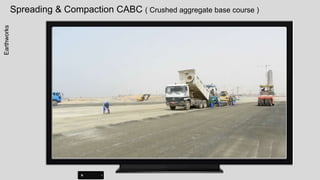

Spreading & Compaction CABC ( Crushed aggregate base course )
Earthworks
Spreading & Compaction CABC ( Crushed aggregate base course )Earthworks
Spreading & Compaction CABC ( Crushed aggregate base course )Earthworks

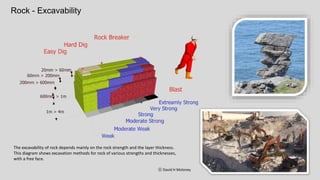

Rock - Excavability
The excavability of rock depends mainly on the rock strength and the layer thickness.
This diagram shows excavation methods for rock of various strengths and thicknesses,
with a free face.
ⓒ David H Moloney
Contents

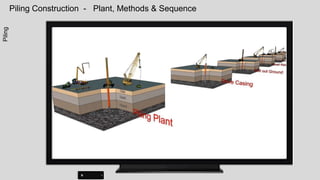

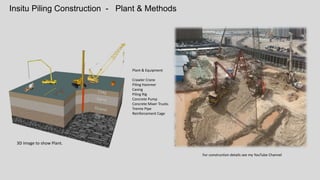

Insitu Piling Construction - Plant & Methods
3D image to show Plant.
For construction details see my YouTube Channel
Plant & Equipment
Crawler Crane
Piling Hammer
Casing
Piling Rig
Concrete Pump
Concrete Mixer Trucks
Tremie Pipe
Reinforcement Cage
Piling Construction - Plant, Methods & SequencePiling

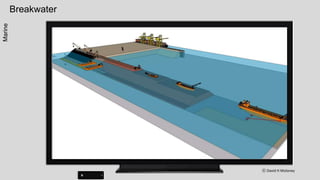

Piling Construction - Plant & MethodsPiling
Pile Load Test
ⓒ David H Moloney
Piling

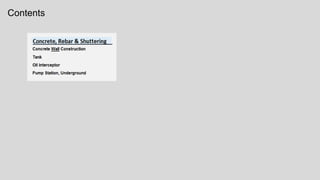

Sheet Pile Shaft Temporary to Support Excavation
Drive Sheet Piles Excavate & install bracing
Construct Concrete Structure Backfill, remove bracing & sheet piles
ⓒ David H Moloney
Sheet pile Temporary Shaft
ⓒ David H Moloney
GeneralItems
3D Animation to show Sequence
Secant Pile Construction - Sequence, Plant & Methods
3D image to show Sequence, Method & Plant.
For construction details see my YouTube Channel
ⓒ David H Moloney
Diaphragm Wall Construction - Sequence, Plant & Methods
3D image to show Sequence, Method & Plant.
For construction details see my YouTube Channel
ⓒ David H Moloney
Contents

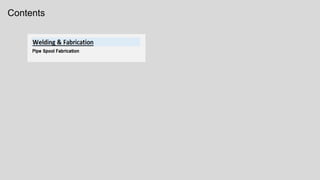

Jetty for Oil Tankers
ⓒ David H Moloney
Marine
Quay Wall
ⓒ David H Moloney
Marine

Breakwater
ⓒ David H Moloney
Marine

Dredging & Reclamation
ⓒ David H Moloney
Marine
Contents

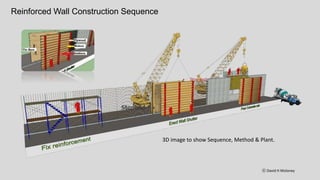

Reinforced Wall Construction Sequence
3D image to show Sequence, Method & Plant.
ⓒ David H Moloney

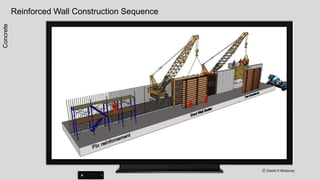

Reinforced Wall Construction Sequence
ⓒ David H Moloney
Concrete
Reinforced Structure Construction Sequence
ⓒ David H Moloney
Concrete
Reinforced Construction Tank Sequence David H Moloney
ⓒ David H Moloney

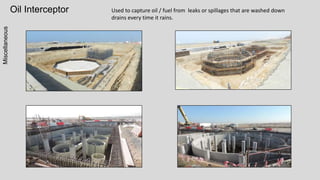

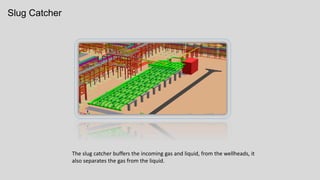

Oil Interceptor
Miscellaneous
Used to capture oil / fuel from leaks or spillages that are washed down
drains every time it rains.
Oil Interceptor
Concrete

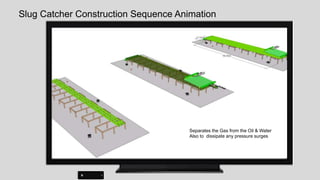

Excavation for Underground Pump stationEarthworks
Brief Description
Faces of excavation Stepped &
Well-point Dewatering used.
Contents
Main Equipment
Path of Construction 45
Slug Catcher
Generators – Gas Turbine Flares
Liquid Train Gas Train Compressors

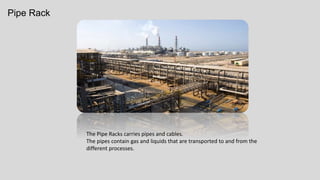

The Pipe Racks carries pipes and cables.
The pipes contain gas and liquids that are transported to and from the
different processes.
Pipe Rack

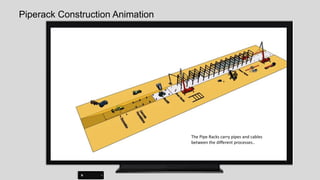

Piperack Construction Animation
The Pipe Racks carry pipes and cables
between the different processes..
Pipe Rack

Pipe Rack - Expansion Loop
49
Gas Processing Facility

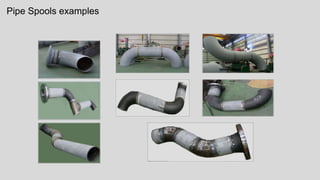

Hanging Scaffold
Stairway Tower

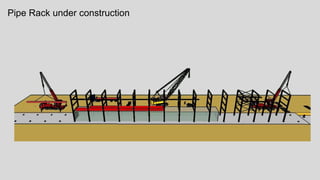

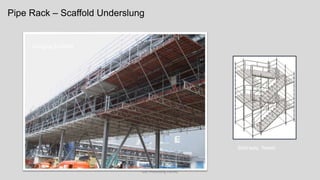

Pipe Rack – Scaffold Underslung
Pipe Rack under construction

The slug catcher buffers the incoming gas and liquid, from the wellheads, it
also separates the gas from the liquid.
Slug Catcher
Slug Catcher Construction Sequence Animation
Separates the Gas from the Oil & Water
Also to dissipate any pressure surges
Slug Catcher

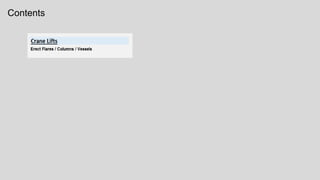

Storage of Oil & Water
Steel Circular Tanks Construction
Steel Storage Tank
ⓒ David H Moloney
StructuralSteel
Steel Circular Storage Tank – Construction ⓒ David H Moloney
Contents
Piping Spool Fabrication
Piping Spools are pre-fabricated from pipes and pipe fittings in fabrication shops to
reduce on site fabrication costs and provide better quality.
Spool Fabrication in Workshop
Pipework

Pipe Spools examples
Spool Fabrication on site

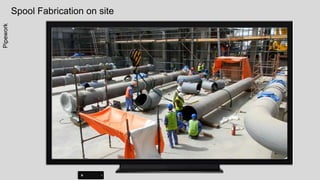

Pipework
Post Weld Heat
Treatment
Non Destructive
Testing
Cut
Bevel
Fit-up
Weld
NDT
PWHT
Blasting
Painting
Spool Fabrication Steps
Welding Trials
Welding
Fit up Clamp

Spool Fabrication - Pipe Rolling & Cutting Table
Pipework
Spool Fabrication Spool Rolling & Welding
Pipework
W. Soule & Company USA
Spool Fabrication - Automatic Welding with Pipe Rolling
Pipework
W. Soule & Company USA

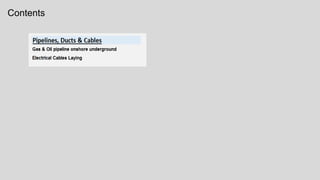

Welding Positioner / Turntable
Pipework
Anyeke.com.my
Contents

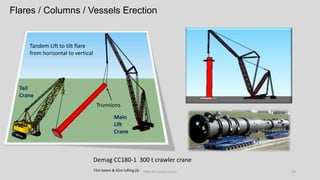

Erect Flares / Columns & Vessels
Cranes Heavy Lift Animation
Lift column from the horizontal and
rotate into the vertical
Gas Processing Facility

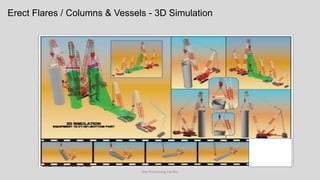

Erect Flares / Columns & Vessels - 3D Simulation
Flares / Columns / Vessels Erection
Path of Construction 74
Demag CC180-1 300 t crawler crane
72m boom & 42m luffing jib

Tandem Lift to tilt flare
from horizontal to vertical
Trunnions
Main
Lift
Crane
Tail
Crane
Contents

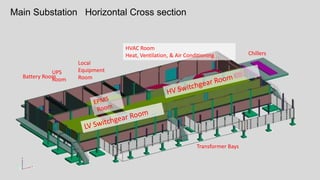

Electrical Sub Station 3D Model
3D Model – Used to provide a better understanding
Main Substation Horizontal Cross section
Transformer Bays
HVAC Room
Heat, Ventilation, & Air Conditioning
Battery Room
UPS
Room
Local
Equipment
Room
Chillers
Electrical Sub Station
3D Model - Horizontal cross sections moving upwards

Electrical Sub Station
3D Model - Vertical cross sections moving along building
Structural Steel Building Single Storey
3D images to show Construction Sequence.
ⓒ David H Moloney
Step 1 Set-out Grid Lines Step 2 Holding Down Bolts Step 3 Erect 1st Bay
Step 4 Erect 2nd Bay Step 5 Erect following Bays
Steel Building Single Storey
ⓒ David H Moloney
StructuralSteel
Structural Steel Building Multi Storey
ⓒ David H Moloney
Step 1 Set-out Grid Lines Step 2 Holding Down Bolts Step 3 Erect 1st level use core for stability
Step 4 Complete 1st Level Step 5 Erect following Levels Step 6 Plumb & Align Structure
3D images to show Construction Sequence.

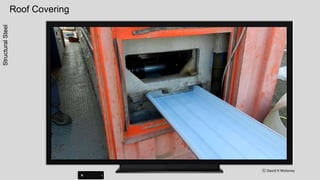

Roof Covering
ⓒ David H Moloney
StructuralSteel
Brief Description
Sequence is
Fix bottom sheet
Fix Vapour barrier
Fix Top Hat section and clips
Fit Insulation
Fix top sheet
Roof Covering
ⓒ David H Moloney
StructuralSteel
Roof Covering
ⓒ David H Moloney
StructuralSteel
Roof Covering
ⓒ David H Moloney
StructuralSteel
Contents

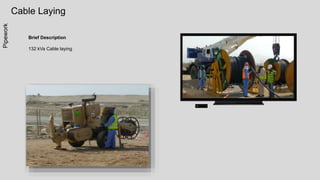

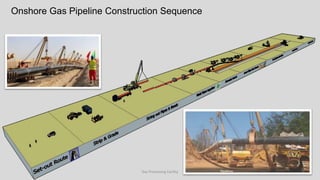

Onshore Gas Pipeline Construction Sequence
Gas Processing Facility
Construction of Azerbaijan Oil Pipeline 42” by 450km.
Overview Construction Sequence
A typical sequence of activities is- surveying and setting out, preparing the land, stringing out the pipes along the
route, excavating the trench, welding and laying the pipes, backfilling the trench with the excavated soil, and
reinstating the land to its original condition.
.
Crossing Railway, Roads, Rivers, etc.
Pump Station
Oil Pipeline 42”
Contents
Overview
Surveying & Setting Out
Clearing & Grading
Double Jointing i.e. welding 2 pipes together
Stringing out Pipes
Bend Pipes for changes in direction sideways and up & down
Welding Pipes into a string, Test Weld by X Ray.
Anti-corrosion Coat to Joints
Trenching i.e. excavate trench
Lowering pipe string into trench
Backfilling Trench
Reinstatement of Pipeline ROW (Right-of-Way)
Reinstatement of River Banks
Crossing - Horizontal Directional Drilling
Crossing - Thrust Boring
Crossing - River
Hydrotest & Pigging
Tie-in i.e. connect to existing pipeline
Miscellaneous
Pause Slides to Read

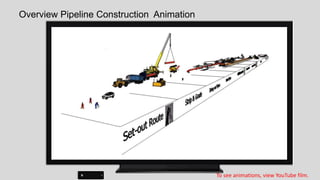

Overview Pipeline Construction Animation
To see animations, view YouTube film.
Cable laying 132KVa Electric
Cable Laying
Pipework
Brief Description

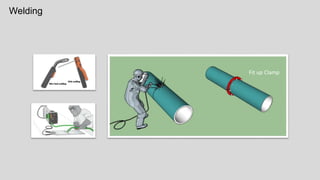

132 kVa Cable laying .
Cable Laying
Pipework
Cable Laying
Pipework
Cable Laying
Pipework
Contents
Horizontal Directional Drilling

Pipework
Brief Description
Horizontal Directional Drilling under a taxiway.
Process
1. A pilot hole id drilled to the designed profile
2. A reamer is pulled back through the hole to enlarge it
3. A pipe string is pulled into the hole.
Horizontal Directional Drilling
Pipework
Crossings – River, Motorway & Rail
Pipework
Overview Pipeline Crossings Construction Animation
Micro Tunnelling
Tunnels
Micro Tunnelling Sequence David H Moloney
ⓒ David H Moloney
Tunnels
Contents
Includes Sequence, Methods & Equipment
Road Construction
Road Construction Sequence Animation

Asphalt Pavement

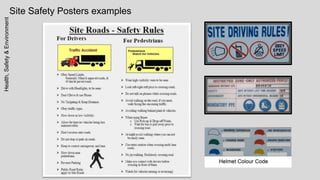

Includes Sequence, Methods & Equipment
Fencing & Gates

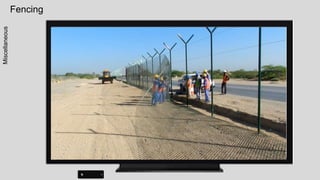

Fencing
ⓒ David H Moloney
Sequence of Construction
Clear Scrub & Grade ground
Fix Corner & Strainer Posts
Fix Intermediate Posts
Fix Line Wire, Chain-link & Razer wire
Concrete ground beam
Fencing
Miscellaneous
Fencing
Miscellaneous
Fencing
Miscellaneous
Fencing
Miscellaneous
Contents
Setting out & Surveying
Setting out & Surveying
Contents
Emergency Phone Numbers & Response
Health,Safety&Environment
HSE Monitoring & Reporting - Dashboard Dashboard is a single page, graphical representation of
current HSE Issues and historical trends
Health,Safety&Environment
Safety Precautions
Health,Safety&Environment
Safety Documents
Health,Safety&Environment
Safe System of Work.
To provide a safe system of work is a legal requirement. What this means is that before you ask an employee to do a
job. You ensure that he has received training, has the appropriate personal protective equipment, the work area is safe
and he is unlikely to be injured or cause damage by carrying out the assigned task.
Project Management Plan for Health, Safety, Security and Environment. also Known as (HSSE Plan)
The Project HSSE Management Plan details how safety on site will be managed.
Project Procedures for Health, Safety, Security & Environment
Details the safe way to undertake a task
Methods Statements
Are prepared in advance of starting work, to plan a Safe System of Work on site for all activities that carries a risk. The
contents of a Method Statement, typically include:- Scope & Location of the Works, Programme, Roles & Responsibilities
of Staff. Resources, Work Methodologies and Risk Assessment.
Slide 1 of 2
Safety Documents
Health,Safety&Environment
Safety Risk Assessments
Are prepared to identify and evaluate risks, to adopt control measures to reduce or eliminate risks.
COSHH Sheet
The purpose of the Control Of Substances Hazardous to Health sheet is to identify how to prevent or adequately control
workers exposure to hazardous substances.
Permit to Work.
Is a management system used to control high risk activities by ensuring safety measures are in place prior to starting
work.
Types of work for which permits will be required include:
Excavation and the digging of trenches.
Working at height, including on roofs.
Working in confined spaces, for example entering a manhole.
Hot work, which is welding, soldering or cutting steel with angle grinders or by gas torch.
Slide 2 of 2
Safety Training on Site
Miscellaneous The purpose of safety training is to provide the knowledge necessary to
perform a job safely
Safety Training Matrix
Miscellaneous The purpose of safety training is to provide the knowledge necessary to
perform a job safely
Emergency Response Drill
HSE
Drills and exercises are used to rehearse anticipated emergency scenarios
Exposed Existing Underground Utilities
ⓒ David H Moloney

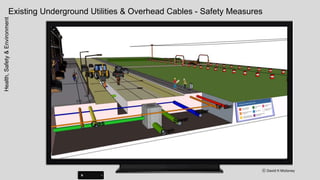

Existing Underground Utilities & Overhead Cables - Safety Measures
ⓒ David H Moloney
Health,Safety&Environment
Trench - Safety Measures
Health,Safety&Environment
Trench - Safety Measures
ⓒ David H Moloney
Health,Safety&Environment
Site Safety Posters examples
Health,Safety&Environment
Personal Protective Equipment (PPE)
Health,Safety&Environment
Personal protective
equipment (PPE) is
protective clothing,
helmets, goggles, or other
garments or equipment
designed to protect the
wearer from injury or
infection
Environmentally Friendly Site Air, Noise, Water & Soil PollutionHealth,Safety&Environment
Water Pollution PreventionHealth,Safety&Environment
Segregation of WasteHealth,Safety&Environment
Segregation of waste for proper disposal and
recycling. Less waste goes to landfill and
hazardous waste is treated to make it safe.
Colour Code for Skips & Bins
Putting Waste Concrete to use
ⓒ David H Moloney
Health,Safety&Environment Precast bases for signs and hoarding,
Precast blocks for walls.
Contents
Staff Directory
Brief Description
List of staff and their
contact details
Daily Work Record
Brief Description
Daily Work Records showing the
allocation of resources, materials and
work activities carried out daily.
Organogram
Brief Description
Shown are the line and
lateral relationships
between the various team
members and their relative
position in the site
organisation.
Filing System
Quotations Comparison Sheet
Staff Responsibility Matrix
Contents
Quality Assurance Dashboard Dashboard is a single page, graphical representation of
current statistics and historical trends
Site Laboratory
Generalitems
Contents
Progress Monitoring & Reporting - Dashboard
ⓒ David H Moloney
Dashboard is a single page, graphical representation of current progress and historical trends
Programme for Construction
Gantt Charts to plan and schedule projects

Primary Substation-
Chiller Plant
Pump House
IRRIGATION WATER TANKS
Irrigation Pump House-
POTABLE/FIRE WATER TANK
Programme using Timeline & 3D Images
Airport Central Utility Yard
Pump House
Piling
Primary Substation-711
Chiller Plant-714
Pump House-
715
Irrigation Pump House-
716
Primary Substation-711
Chiller Plant-714
Pump House-
715
IRRIGATION WATER TANK
Irrigation Pump House-
716
Primary Substation-711
Chiller Plant-714
Pump House-
715
IRRIGATION WATER TANK
Irrigation Pump House-
716
Primary Substation-711
Chiller Plant-714
Pump House-
715
IRRIGATION WATER TANK
Irrigation Pump House-
716
Primary Substation-711
Chiller Plant-714
Pump House-
715
IRRIGATION WATER TANK
Irrigation Pump House-
716
POTABLE/FIRE WATER TANK
Time Chainage Diagram The chart has two axis: one for time and the other for location
A legend explains meaning of the colours, symbols and line types
Sample Only
Histogram Charts for Resources & Outputs
Concrete, Manpower, TBM,
Manpower per Discipline Concrete per Location
Numbers for each month of the Project Quantity for each month of the Project
ⓒ David H Moloney
Plant & Equipment List & Worker’s Job Titles
ⓒ David H Moloney
Contents
Temporary Contractors Site Facilities
ⓒ David H Moloney
Brief Description
Site Offices, Camp Accommodation for
1,250 workers, Canteen, Recreation,
Fabrication shops, Stores, Plant Yard. In five
locations along the route.
Welfare Facilities
ⓒ David H Moloney
GeneralItems
Toilets – Washing
Canteen, Drying Room, Toilet & Generator

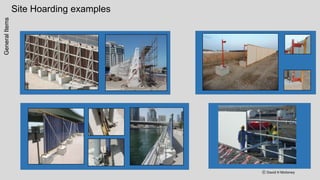

Site Hoarding examples
ⓒ David H Moloney
GeneralItems
Temporary Electricity Supply & Tower Lights
ⓒ David H Moloney
GeneralItems

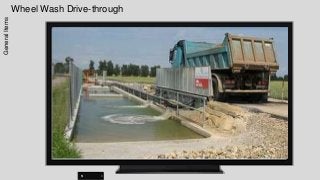

Wheel Wash Drive-through
ⓒ David H Moloney
GeneralItems
Used to wash the wheels of trucks prior to leaving site.
Wheel Wash Drive-throughGeneralItems
Weighbridge & Sheeting Access
ⓒ David H Moloney
GeneralItems Access tower for covering tipper truck bodies to
prevent air pollution.
Dust Suppression
ⓒ David H Moloney
GeneralItems
Wetting the ground to prevent dust blowing in the wind
Dewatering

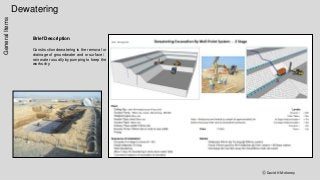

ⓒ David H Moloney
GeneralItems
Brief Description
Construction dewatering is the removal or
drainage of groundwater and or surface /
rain water usually by pumping to keep the
works dry.
Dewatering
ⓒ David H Moloney
GeneralItems

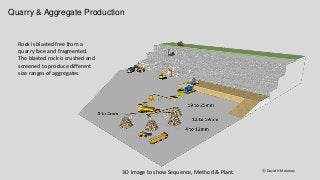

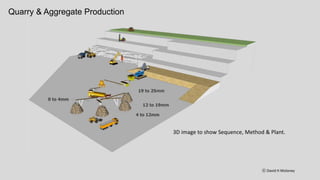

Quarry & Aggregate Production
3D image to show Sequence, Method & Plant. ⓒ David H Moloney
Rock is blasted free from a
quarry face and fragmented.
The blasted rock is crushed and
screened to produce different
size ranges of aggregates
Quarry & Aggregate ProductionGeneralItems

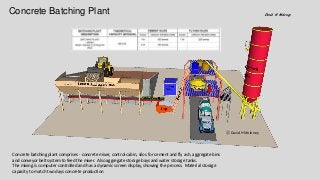

Concrete Batching Plant David H Moloney
ⓒ David H Moloney
Concrete batching plant comprises - concrete mixer, control cabin, silos for cement and fly ash, aggregate bins
and conveyor belt system to feed the mixer. Also aggregate storage bays and water storage tanks.
The mixing is computer controlled and has a dynamic screen display, showing the process. Material storage
capacity to match two days concrete production
Concrete Batching Plant
ⓒ David H Moloney
Concrete
Concrete Batching Yard 3 Nr MixersGeneralItems
Concrete MixGeneralItems
A concrete mix contains 5 major
elements: cement, water, coarse
aggregates, fine aggregates (sand) and
air in different proportion. Additional
elements such as pozzolanic materials (fly
ash, silica fumes or slag) and chemical
admixtures can also be incorporated to
the mix to increase its properties.

Reinforcement Cutting & Bending Yard David H Moloney
ⓒ David H Moloney
Reinforcement in 12 m lengths. Delivery in 3 ton Bundles Reinforcement cut to length by Shearing Machine
Reinforcement Bent to Shape by Bending Machine Reinforcement that is cut and bent is Bundled for delivery to work site
Reinforcement Cutting & Bending
ⓒ David H Moloney
Concrete
Contents
Notes
Production by David H Moloney
My YouTube Channel link: https://www.youtube.com/channel/UCeJR9J7svhBd-C0ZoAH2fhQ
ⓒ David H Moloney

Oil & Gas Plant Construction, Project Execution Plan
