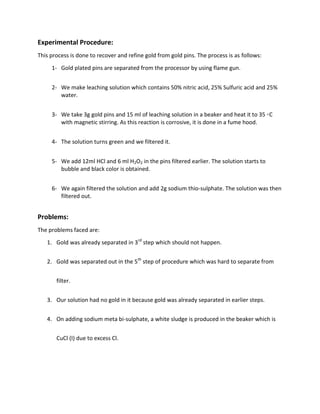

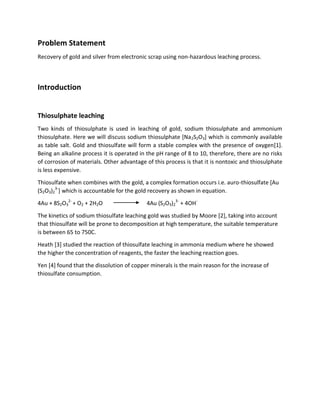

This progress report discusses the development of a non-hazardous process for leaching metals from electronic scrap using sodium thiosulfate. The report outlines problems with an initial experimental procedure that attempted to recover gold from gold pins using nitric acid, sulfuric acid, and hydrogen peroxide solutions. These caused gold to separate prematurely from the solution. The report proposes using either an acid/peroxide or aqua regia process instead, and provides details on making a "poor man's aqua regia" solution using sodium nitrate, hydrochloric acid, and water. Maintaining the sodium thiosulfate solution at 65°C or above and using a hydrogen peroxide concentration of 3-5% are also recommended
