FNBE April 2014
Introduction to Construction Industry
Final Project Report
Name: Chong Yu Xuan (0317950)
Kong Zhen Chung (0319528)
Lecturer: Pn. Hasmanira Mokhtar

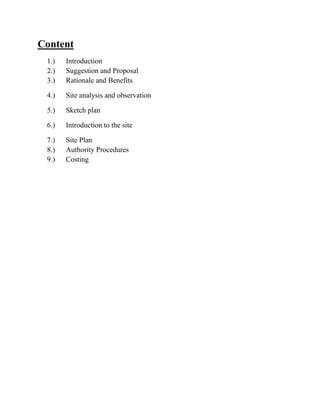

Content
1.) Introduction
2.) Suggestion and Proposal
3.) Rationale and Benefits
4.) Site analysis and observation
5.) Sketch plan
6.) Introduction to the site
7.) Site Plan
8.) Authority Procedures
9.) Costing
Introduction

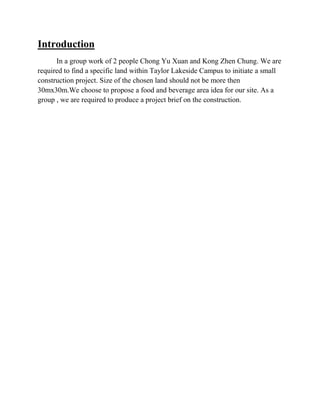

In a group work of 2 people Chong Yu Xuan and Kong Zhen Chung. We are
required to find a specific land within Taylor Lakeside Campus to initiate a small
construction project. Size of the chosen land should not be more then
30mx30m.We choose to propose a food and beverage area idea for our site. As a
group , we are required to produce a project brief on the construction.
Suggestion and proposal

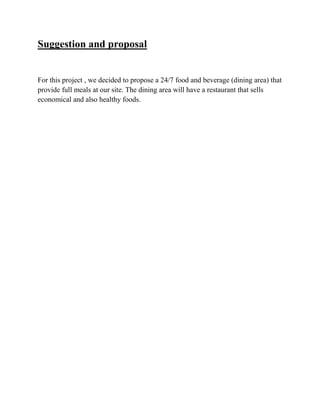

For this project , we decided to propose a 24/7 food and beverage (dining area) that
provide full meals at our site. The dining area will have a restaurant that sells
economical and also healthy foods.
Rationale and Benefits
Rationale
According to our survey and research many students usually does their
assignments till late night in the studios and classrooms of block E. The only eatery
available till late night are “Mamak” and seven eleven for snacks. These eatery are
oily and unhealthy which will cause health problems after overconsumption.
Furthermore, the food and beverages in Taylor’s Lakeside Campus are overpriced
and unsuitable for student ,all the more reason for an economical eatery.
Benefits

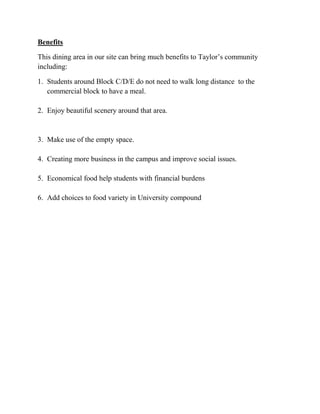

This dining area in our site can bring much benefits to Taylor’s community
including:
1. Students around Block C/D/E do not need to walk long distance to the
commercial block to have a meal.
2. Enjoy beautiful scenery around that area.
3. Make use of the empty space.
4. Creating more business in the campus and improve social issues.
5. Economical food help students with financial burdens
6. Add choices to food variety in University compound

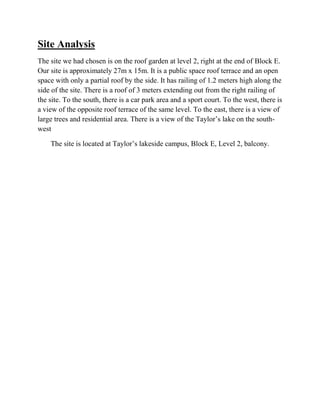

Site Analysis
The site we had chosen is on the roof garden at level 2, right at the end of Block E.
Our site is approximately 27m x 15m. It is a public space roof terrace and an open
space with only a partial roof by the side. It has railing of 1.2 meters high along the
side of the site. There is a roof of 3 meters extending out from the right railing of
the site. To the south, there is a car park area and a sport court. To the west, there is
a view of the opposite roof terrace of the same level. To the east, there is a view of
large trees and residential area. There is a view of the Taylor’s lake on the south-
west
The site is located at Taylor’s lakeside campus, Block E, Level 2, balcony.
Key Plan

Location Plan

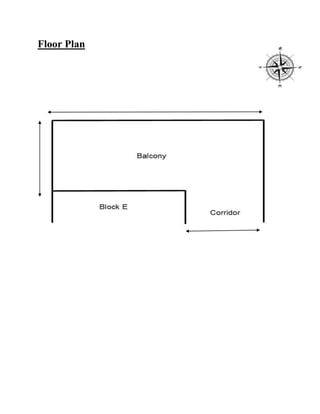

Floor Plan
In our site, it is free from air pollution, this is because our site is surrounded by
the car park spaces which is away from the roads. Our site also located at higher
level than the car park spaces. The wind strength in our site is average because our
site is attached to the block E building. Our site is located at block E, level 2. The
temperature in our site is normal because there are slow wind blowing toward our
site and our site is avoid from sun except in the afternoon half of our site will
explored by the sunlight. The only sound pollution faced in our site are the
condenser of the air conditional attached to the wall of buildings beside our site.
In front of the balcony, it’s a car park and
this is the view from our site looking
towards the car park.
The railing around the perimeter of the
balcony. It’s a 1m tall railing around the
balcony and it’s lifted by 15cm concrete step.
Sun Orientation
The sunlight will only reach the balcony
when afternoon 12pm to 2pm. Most area of
the site is shaded.

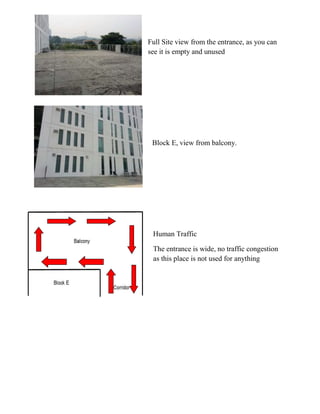

Full Site view from the entrance, as you can
see it is empty and unused
Block E, view from balcony.
Human Traffic
The entrance is wide, no traffic congestion
as this place is not used for anything
Proposed Site Introduction
After complete this project, our site had finally become a food and beverage area. It consists a
kitchen at the corner of our site. There will also be a bar beside the kitchen. The purpose that we
build a bar in it is to serve different types of drinks for the customers.
Rationale:
Students can dine at this area without walking very long distance to the
commercial block.

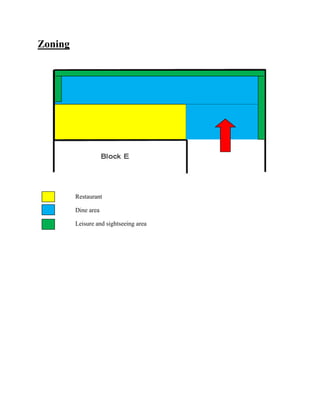

Zoning
Restaurant
Dine area
Leisure and sightseeing area

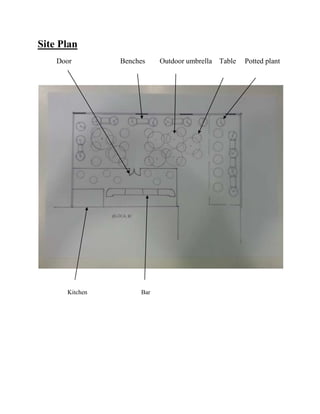

Site Plan
Door Benches Outdoor umbrella Table Potted plant
Kitchen Bar
Authority Procedure
Development order
Submit and obtain Development Approval through OSC
Builders can now apply for construction permits through OSC 1Submission (single entry). OSC will then refer the submissions to
the Planning Department, Building Department, Engineering Department, Fire Department, Sewerage Agency, Water Agency and
the Telecommunication Operators.
OSC will issue the development approval (Planning aprrovals, Building approvals, Engineering approvals, Fire safety plan
endorsements, water approvals, sewerage works approvals and Telecommunications approvals) to the builder. While all forms can
be obtained online at jprb.dbkl.gov.my/Pentadbir/MuatTurunBorangOSC/MTBorang11.asp, the filing has still to be done in person
at the OSC.
Builder will submit and obtain approval through OSC for the following documents:
• Planning plan
• Building plan
• Engineering plan (earthwork, road & drainage plan, road excavation permit & street lighting plan)
• Landscape plan
• Water supply plan
• Sewerage plan
• Infrastructure communication plan
• Fire safety plan
Estimated Processing Costs
1. Planning plan = MYR 500.00
2. Building plan= MYR 1,300.
3. Engineering plan = MYR 100.00
Development order
4. Water supply plan = MYR 1,000.00
1. Submission to Local Authority through OSC
2. Obtain Development Order (DO) from Planning Department
3. Obtain Water Approval
4. Obtain Sewerage Approval
5. Obtain Fire Safety (Arch) Comment
6. Obtain Earthwork Approval
7. Obtain Road and Drainage Approval
8. Obtain Landscape Approval
9. Obtain Street Lighting Approval
10. Obtain MSMA and SPAH Approvals
11. Obtain Building Plan Approval
12. Obtain Fire Safety (M&E) Approval
Agency: Kuala Lumpur City Hall’s One Stop Centre (OSC)
Submit pre-construction notifications to OSC
Under OSC 1Submission, all notifications are submitted via OSC. OSC will then distribute notifications to the relevant agencies
such as:
• Building Department (B Form - notification to start building work)
• Engineering Department (B Form - notification to start earthwork)
• Sewerage Certifying Agency (IWK) (PDC 6 Form - notification to start sewerage work)
Agency: Kuala Lumpur City Hall’s One Stop Centre (OSC)
Request final utilities inspections through OSC
Under OSC 1Submission, the builder has to request for inspections via OSC. OSC will arrange and coordinate inspections and
connections schedule with relevant agencies
1. TELCO connection = MYR495.00
2. Water connection = MYR 30.00
3. Fire safety inspection = MYR 111.00
Agency: Kuala Lumpur City Hall’s One Stop Centre (OSC)
Receive Road and Drainage Final Inspection
Once the road and drainage works has been completed, the builder will request the Road and Drainage clearance letter from the
Engineering Department of CHKL. The builder has to submit a construction report notification and by signing form G 17, the
Engineer certifies that all works were carried out according to regulations. Form G17 will be filed along with Form F (Certificate of
Completion and Compliance (CCC) via OSC to the Engineering Department.
Agency: Sewerage Certifying Agency (IWK)
Obtain Road and Drainage Clearance Letter
Development order
A date for the inspection will be set-up prior to the issuance of clearance letter for the road and drainage work
Agency: Sewerage Certifying Agency (IWK)
Receive Sewage Final Inspection
The Sewerage Certifying Agency (IWK) will carry out an inspection of the sewerage system and issue to the builder a clearance
letter for sewerage.
Agency: Sewerage Certifying Agency (IWK)
Obtain Sewage Clearance Letter
Once the inspection has been carried out, a clearance letter is issued to the Builder. This clearance letter will allow the Engineer to
issue the Certificate of Completion and compliance (CCC).
Agency: Sewerage Certifying Agency (IWK)
Receive Fire Safety Final Inspection
Fire and Rescue Department will carry out fire safety inspection
Agency: Fire and Rescue Department
Obtain Fire Safety Final Letter
Fire and Rescue Department will issue to the builder the clearance letter for fire safety
Agency: Fire Department
Receive Water Inspection
Water Authority SYABAS will conduct an onsite inspection of the works and make the connection to the public pipe.
Agency: Water Authority SYABAS
Submit Water Test and Commissioning (T&C) Report
Water Authority SYABAS will conduct an onsite inspection of the works and make the connection to the public pipe.
Agency: Water Authority SYABAS
Obtain Water Clearance Letter
The Water Authority SYABAS will issue a clearance letter to the builder and install the water meter at the same time for water
connection.
Agency: Water Authority SYABAS
Builder’s Principal Submitting Person files the Certificate of Completion and compliance (CCC)
The Builder’s Principal Submitting Person (professional|architect) will issue Certificate of Completion and compliance (Form F -
CCC) to the Builder/Owner and 2 copies of the CCC will be filed at the OSC for the Building Department (JRBB) and the Board of
Architects/Engineers (LAM/LJM).
Agency: Building Department and Board of Architect via OSC.
Obtain Water Connection
Agency: Water Authority SYABAS
Obtain Telco Connection
Costing

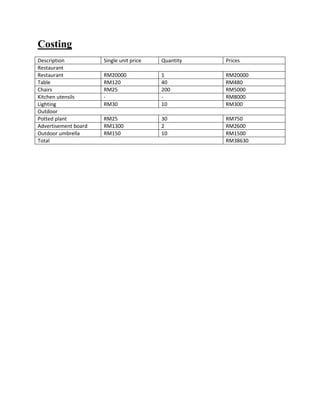

Description Single unit price Quantity Prices
Restaurant
Restaurant RM20000 1 RM20000
Table RM120 40 RM480
Chairs RM25 200 RM5000
Kitchen utensils - - RM8000
Lighting RM30 10 RM300
Outdoor
Potted plant RM25 30 RM750
Advertisement board RM1300 2 RM2600
Outdoor umbrella RM150 10 RM1500
Total RM38630

Ici final project

  • 1.
    FNBE April 2014 Introductionto Construction Industry Final Project Report Name: Chong Yu Xuan (0317950) Kong Zhen Chung (0319528) Lecturer: Pn. Hasmanira Mokhtar
  • 2.
    Content 1.) Introduction 2.) Suggestionand Proposal 3.) Rationale and Benefits 4.) Site analysis and observation 5.) Sketch plan 6.) Introduction to the site 7.) Site Plan 8.) Authority Procedures 9.) Costing
  • 3.
    Introduction In a groupwork of 2 people Chong Yu Xuan and Kong Zhen Chung. We are required to find a specific land within Taylor Lakeside Campus to initiate a small construction project. Size of the chosen land should not be more then 30mx30m.We choose to propose a food and beverage area idea for our site. As a group , we are required to produce a project brief on the construction.
  • 4.
    Suggestion and proposal Forthis project , we decided to propose a 24/7 food and beverage (dining area) that provide full meals at our site. The dining area will have a restaurant that sells economical and also healthy foods.
  • 5.
    Rationale and Benefits Rationale Accordingto our survey and research many students usually does their assignments till late night in the studios and classrooms of block E. The only eatery available till late night are “Mamak” and seven eleven for snacks. These eatery are oily and unhealthy which will cause health problems after overconsumption. Furthermore, the food and beverages in Taylor’s Lakeside Campus are overpriced and unsuitable for student ,all the more reason for an economical eatery.
  • 6.
    Benefits This dining areain our site can bring much benefits to Taylor’s community including: 1. Students around Block C/D/E do not need to walk long distance to the commercial block to have a meal. 2. Enjoy beautiful scenery around that area. 3. Make use of the empty space. 4. Creating more business in the campus and improve social issues. 5. Economical food help students with financial burdens 6. Add choices to food variety in University compound
  • 7.
    Site Analysis The sitewe had chosen is on the roof garden at level 2, right at the end of Block E. Our site is approximately 27m x 15m. It is a public space roof terrace and an open space with only a partial roof by the side. It has railing of 1.2 meters high along the side of the site. There is a roof of 3 meters extending out from the right railing of the site. To the south, there is a car park area and a sport court. To the west, there is a view of the opposite roof terrace of the same level. To the east, there is a view of large trees and residential area. There is a view of the Taylor’s lake on the south- west The site is located at Taylor’s lakeside campus, Block E, Level 2, balcony.
  • 8.
  • 9.
  • 10.
  • 11.
    In our site,it is free from air pollution, this is because our site is surrounded by the car park spaces which is away from the roads. Our site also located at higher level than the car park spaces. The wind strength in our site is average because our site is attached to the block E building. Our site is located at block E, level 2. The temperature in our site is normal because there are slow wind blowing toward our site and our site is avoid from sun except in the afternoon half of our site will explored by the sunlight. The only sound pollution faced in our site are the condenser of the air conditional attached to the wall of buildings beside our site. In front of the balcony, it’s a car park and this is the view from our site looking towards the car park. The railing around the perimeter of the balcony. It’s a 1m tall railing around the balcony and it’s lifted by 15cm concrete step. Sun Orientation The sunlight will only reach the balcony when afternoon 12pm to 2pm. Most area of the site is shaded.
  • 12.
    Full Site viewfrom the entrance, as you can see it is empty and unused Block E, view from balcony. Human Traffic The entrance is wide, no traffic congestion as this place is not used for anything
  • 13.
    Proposed Site Introduction Aftercomplete this project, our site had finally become a food and beverage area. It consists a kitchen at the corner of our site. There will also be a bar beside the kitchen. The purpose that we build a bar in it is to serve different types of drinks for the customers. Rationale: Students can dine at this area without walking very long distance to the commercial block.
  • 14.
  • 15.
    Site Plan Door BenchesOutdoor umbrella Table Potted plant Kitchen Bar
  • 17.
    Authority Procedure Development order Submitand obtain Development Approval through OSC Builders can now apply for construction permits through OSC 1Submission (single entry). OSC will then refer the submissions to the Planning Department, Building Department, Engineering Department, Fire Department, Sewerage Agency, Water Agency and the Telecommunication Operators. OSC will issue the development approval (Planning aprrovals, Building approvals, Engineering approvals, Fire safety plan endorsements, water approvals, sewerage works approvals and Telecommunications approvals) to the builder. While all forms can be obtained online at jprb.dbkl.gov.my/Pentadbir/MuatTurunBorangOSC/MTBorang11.asp, the filing has still to be done in person at the OSC. Builder will submit and obtain approval through OSC for the following documents: • Planning plan • Building plan • Engineering plan (earthwork, road & drainage plan, road excavation permit & street lighting plan) • Landscape plan • Water supply plan • Sewerage plan • Infrastructure communication plan • Fire safety plan Estimated Processing Costs 1. Planning plan = MYR 500.00 2. Building plan= MYR 1,300. 3. Engineering plan = MYR 100.00
  • 18.
    Development order 4. Watersupply plan = MYR 1,000.00 1. Submission to Local Authority through OSC 2. Obtain Development Order (DO) from Planning Department 3. Obtain Water Approval 4. Obtain Sewerage Approval 5. Obtain Fire Safety (Arch) Comment 6. Obtain Earthwork Approval 7. Obtain Road and Drainage Approval 8. Obtain Landscape Approval 9. Obtain Street Lighting Approval 10. Obtain MSMA and SPAH Approvals 11. Obtain Building Plan Approval 12. Obtain Fire Safety (M&E) Approval Agency: Kuala Lumpur City Hall’s One Stop Centre (OSC) Submit pre-construction notifications to OSC Under OSC 1Submission, all notifications are submitted via OSC. OSC will then distribute notifications to the relevant agencies such as: • Building Department (B Form - notification to start building work) • Engineering Department (B Form - notification to start earthwork) • Sewerage Certifying Agency (IWK) (PDC 6 Form - notification to start sewerage work) Agency: Kuala Lumpur City Hall’s One Stop Centre (OSC) Request final utilities inspections through OSC Under OSC 1Submission, the builder has to request for inspections via OSC. OSC will arrange and coordinate inspections and connections schedule with relevant agencies 1. TELCO connection = MYR495.00 2. Water connection = MYR 30.00 3. Fire safety inspection = MYR 111.00 Agency: Kuala Lumpur City Hall’s One Stop Centre (OSC) Receive Road and Drainage Final Inspection Once the road and drainage works has been completed, the builder will request the Road and Drainage clearance letter from the Engineering Department of CHKL. The builder has to submit a construction report notification and by signing form G 17, the Engineer certifies that all works were carried out according to regulations. Form G17 will be filed along with Form F (Certificate of Completion and Compliance (CCC) via OSC to the Engineering Department. Agency: Sewerage Certifying Agency (IWK) Obtain Road and Drainage Clearance Letter
  • 19.
    Development order A datefor the inspection will be set-up prior to the issuance of clearance letter for the road and drainage work Agency: Sewerage Certifying Agency (IWK) Receive Sewage Final Inspection The Sewerage Certifying Agency (IWK) will carry out an inspection of the sewerage system and issue to the builder a clearance letter for sewerage. Agency: Sewerage Certifying Agency (IWK) Obtain Sewage Clearance Letter Once the inspection has been carried out, a clearance letter is issued to the Builder. This clearance letter will allow the Engineer to issue the Certificate of Completion and compliance (CCC). Agency: Sewerage Certifying Agency (IWK) Receive Fire Safety Final Inspection Fire and Rescue Department will carry out fire safety inspection Agency: Fire and Rescue Department Obtain Fire Safety Final Letter Fire and Rescue Department will issue to the builder the clearance letter for fire safety Agency: Fire Department Receive Water Inspection Water Authority SYABAS will conduct an onsite inspection of the works and make the connection to the public pipe. Agency: Water Authority SYABAS Submit Water Test and Commissioning (T&C) Report Water Authority SYABAS will conduct an onsite inspection of the works and make the connection to the public pipe. Agency: Water Authority SYABAS Obtain Water Clearance Letter The Water Authority SYABAS will issue a clearance letter to the builder and install the water meter at the same time for water connection. Agency: Water Authority SYABAS Builder’s Principal Submitting Person files the Certificate of Completion and compliance (CCC) The Builder’s Principal Submitting Person (professional|architect) will issue Certificate of Completion and compliance (Form F - CCC) to the Builder/Owner and 2 copies of the CCC will be filed at the OSC for the Building Department (JRBB) and the Board of Architects/Engineers (LAM/LJM). Agency: Building Department and Board of Architect via OSC. Obtain Water Connection Agency: Water Authority SYABAS Obtain Telco Connection
  • 20.
    Costing Description Single unitprice Quantity Prices Restaurant Restaurant RM20000 1 RM20000 Table RM120 40 RM480 Chairs RM25 200 RM5000 Kitchen utensils - - RM8000 Lighting RM30 10 RM300 Outdoor Potted plant RM25 30 RM750 Advertisement board RM1300 2 RM2600 Outdoor umbrella RM150 10 RM1500 Total RM38630
