The document outlines the roles and responsibilities of an IT Project Management Office (PMO) for a large Systems Integration project using the ASAP (Accelerated SAP) methodology. It describes the six phases of the ASAP methodology and provides details on deliverables, milestones, and objectives for each phase. It also defines the roles of various project managers, administrators, and SAP specialists involved in the project and how they would be organized and report within the proposed PMO structure.
Learn SAP BusinessObjects BI platform 4.1 Architecture with a neat diagram and overview, And also watch sap bo architecture business intelligence Architecture video tutorial
Building the Business Case for SAP HANAJohn Appleby
This presentation discusses an approach to building the business case for SAP HANA, including practical advice on getting a project live, fast.
This was first presented at the SAP Insider HANA 2015 conference in Las Vegas
Leverage SAP Activate Methodology to implement S/4HANA for maximized benefits. Best deployment and configuration practices revealed. Read our PPT for in-depth knowledge.
Learn SAP BusinessObjects BI platform 4.1 Architecture with a neat diagram and overview, And also watch sap bo architecture business intelligence Architecture video tutorial
Building the Business Case for SAP HANAJohn Appleby
This presentation discusses an approach to building the business case for SAP HANA, including practical advice on getting a project live, fast.
This was first presented at the SAP Insider HANA 2015 conference in Las Vegas
Leverage SAP Activate Methodology to implement S/4HANA for maximized benefits. Best deployment and configuration practices revealed. Read our PPT for in-depth knowledge.
This presentation talks about how SAP S/4HANA can empower finance to strategically guide your business evolution via instant insights, intuitive user experience, and a flexible non-disruptive platform.
SAP S/4HANA: Everything you need to know for a successul implementationBluefin Solutions
As well as helping you build a business case for SAP S/4HANA, this presentation will cover:
1) SAP S/4HANA in a nutshell
2) Migrating to SAP S/4HANA
3) What is Central Finance and why should I use it?
4) Planning in SAP BPC for S/4HANA
5) SAP S/4HANA Finance
This was presented on 04/11/15 at:
SAP S/4HANA: Everything you need to know for a successful implementation
London
SAP Project Management: Major Responsibilities And Key TaskAnjali Rao
Normally call as ASAP -One of the Methodology for Implementing SAP. Here we will discuss the major risk factor involved in Project Management,role and responsibilities of Project Team and opportunities.
Get the inside scoop of the future innovations of the SAP BusinessObjects BI 4.3 platform: hybrid world, new BI Launchpad interface, simplified maintenance, as well as other exciting innovations.
SAP Implementation And Strategies- Basic Guidelines For Project ManagerAnjali Rao
Project Manager develops the Project Plan with the team and manages the team's performance of project tasks.As a profession,It is both a science and an art, following a systematic process
This presentation talks about how SAP S/4HANA can empower finance to strategically guide your business evolution via instant insights, intuitive user experience, and a flexible non-disruptive platform.
SAP S/4HANA: Everything you need to know for a successul implementationBluefin Solutions
As well as helping you build a business case for SAP S/4HANA, this presentation will cover:
1) SAP S/4HANA in a nutshell
2) Migrating to SAP S/4HANA
3) What is Central Finance and why should I use it?
4) Planning in SAP BPC for S/4HANA
5) SAP S/4HANA Finance
This was presented on 04/11/15 at:
SAP S/4HANA: Everything you need to know for a successful implementation
London
SAP Project Management: Major Responsibilities And Key TaskAnjali Rao
Normally call as ASAP -One of the Methodology for Implementing SAP. Here we will discuss the major risk factor involved in Project Management,role and responsibilities of Project Team and opportunities.
Get the inside scoop of the future innovations of the SAP BusinessObjects BI 4.3 platform: hybrid world, new BI Launchpad interface, simplified maintenance, as well as other exciting innovations.
SAP Implementation And Strategies- Basic Guidelines For Project ManagerAnjali Rao
Project Manager develops the Project Plan with the team and manages the team's performance of project tasks.As a profession,It is both a science and an art, following a systematic process
Study the potential effect that ERP si-mulations can have on a potential ERP system user skills and knowledge, and thereafter find the potential impact that they may have while being used during an ERP implementation to facilitate training and reduce resis-tance to change.
Leading Organizations – Bigger Challenges
The organization chart may be useful in determining who to call when you are going to be late for work, but job responsibilities change far more rapidly than organization charts. Matrix organizations create another layer of complexity. Communication is one of the top reasons that teams do not achieve their goals, and the communication links between important stakeholders may not even be shown on a traditional org chart, as is the case with suppliers, alliance partners, and customers. As a result, leaders may find themselves responsible for teams of people who do not report to them. A directive approach in these circumstances works even less well than it does with subordinates where there is a reporting relationship. Leading effectively in these circumstances requires a disciplined framework for generating results predictably and repeatedly. Technology and process excellence will only get you so far. Ultimately it is the people who make an organization successful, and successful organizational leaders must master the three “P”s – Product subject matter knowledge, Process excellence, and influential People skills. Identifying roles and responsibilities separate from position or title is a start. Creating a mutually beneficial purpose, compelling vision, clear mission and shared values that bring the various stakeholders together to collaborate in achieving the goals is essential. What gets measured is what gets done. Progress toward success must be monitored and measured, then shared with all relevant stakeholders. The five one-page tools presented in this module can make all of this manageable without unnecessary bureaucracy.
In this talk Margaret Armstrong, PMO Manager at the Trust explains how it has established a central Project Management Office in IT with strong, pragmatic processes to oversee the wide range of projects underway, underpinned by Bestoutcome’s PM3 tool, and describes the benefits this has brought, including significant improvements in Board reporting.
The NHS is undergoing significant change in the way it manages the delivery of services. At Warrington, the Trust Board launched a transformational change programme to review and improve all aspects of the way it works, including the delivery of IT services.
This is the presentation from Project Challenge 2015 on March 26th 2015 at National Motorcycle Museum, Birmingham, London, UK
For the Business Block, my project group and I research Chevron Corporation, analyzed its financial statements, market position, and competitors to ultimately assert whether investors should purchase stock in the company. We took the corporation's financial ratios (which was chiefly my responsibility), marketing efforts, operational efficiency, SWOT analysis, and accounting methods into account, and determined that investors ought to buy stock in the firm at the given time.
Many organizations who have not previously used the powerful financial capabilities of Clarity PPM are finding it advantageous to see planned and actual financial status of their projects. Too often companies hesitate taking that first step due to the perceived complexity of setting up and maintaining financial data in Clarity PPM.
This presentation, Clarity PPM Financials Made Easy, will address:
How to set up Clarity PPM Financials at a low cost and high-value structure
Taking advantage of default settings to reduce complexity and maintenance
Advantages of seeing all the relevant data in one place
Use of simple models to get started or use as a Proof of Concept
Optional Clarity PPM Features to enhance the model
The CA Clarity PPM Financials module enables users to see the financial impact of plans and measure performance results against the expectations of those plans. As changes to the plan are made, users can see how those changes will affect the financial outcomes.
Here is the Project Time Management Part 1 as a part of PMP Training by SKillogic Knowledge Solutions. Other slides will upload soon.
If you are looking for PMP Certification training classes in Bangalore, Chennai, Delhi, Hyderabad, and Mumbai visit http://in.skillogic.com/
Here is the next slides of Skillogic PMP Training. The slides will explain about Project Integration Management. This is only Part 1 and will upload part 2 soon.
Skillogic Knowledge Solutions is providing PMP Classroom Training in India across many Cities like Hyderabad, Bengaluru, Chennai etc. If you are looking for PMP training in Hyderabad visit: http://in.skillogic.com/pmp-training/pmp-certification-hyderabad
CRMready Webinar Series - Part 3 - How to Make Your Nonprofit’s CRM Implement...TheConnectedCause
In the CRMready Webinar Series, The Connected Cause takes a look at what CRM is, the project roles needed for a successful CRM implementation, and project management. In part 3 Heller Consulting talks about managing expectations with change management, evaluating risks with a CRM implementation and what roles are needed to ensure the project is a success for your nonprofit organization.
Sabrion has a highly qualified team of retail/manufacturing process experts and IT consultants, supporting both short and long-term needs. Our FastForward implementation methodology to support PLM and Merchandise planning.
Project Management
PMI – Project Management Institute
PMBOK – Project Management Body of Knowledge
Agile – We utilize Agile, Scrum, and Extreme methodologies when appropriate
We are flexible to embrace the methodologies used by our customers an business partners
Retail/Manufacturing Business Process Re – Engineering
As-Is and To-Be Modeling, SIPOC, RACI, Impact Analysis, Standard Operating Procedures
Application Design, Development and Integration
UML – Unified Modeling Language
Open Internet and Standards, HTML5, CSS3, JQuery, Javascript, Web Frameworks
Application Architecture
Application Infrastructure Design – Virtualization, Cloud, Application Servers, Storage, Web DMZ
Global Network Design – LAN, WAN, MPLS, Reverse Proxy, CDN
Deployment Architecture – Dev, QA, Staging, Production
Annual Operations (AOP) and Long-Range (LRP) Planning ProcessDavid Niles
Outline an approach to the development of an Annual Operating Plan (AOP) and Long-Range Planning (LRP) process. Show an appropriate timeline to this process.
Describe the background to Hoshin Charts, Affinity Diagrams and how they fit into the AOP and LRP processes
Illustrate examples of Enterprise Infrastructure Goals and Objectives for a large manufacturing organization, and how they could fit into an AOP.
eCIO PPT Roles for a SAP and Systems Integration Project

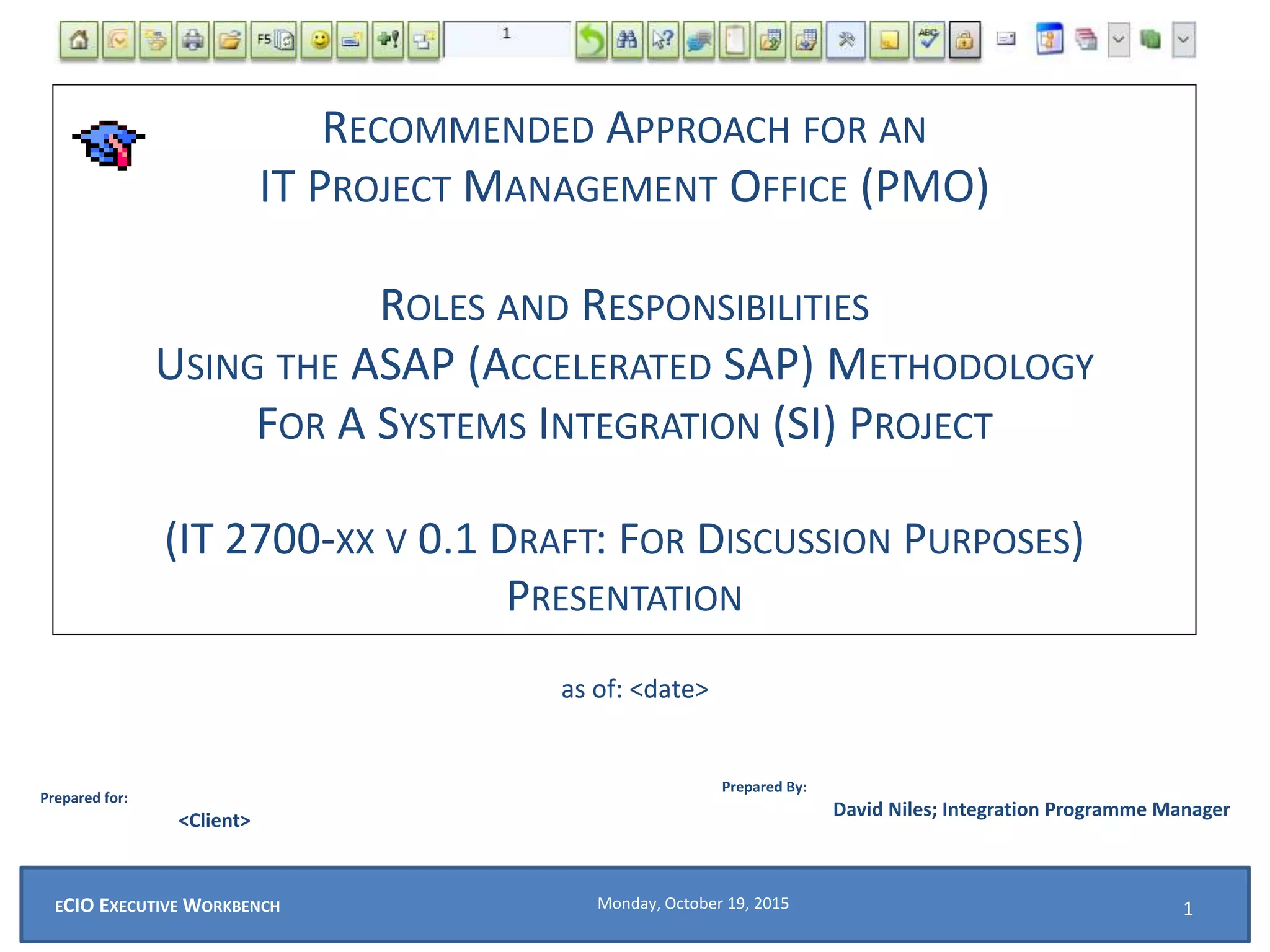

1. RECOMMENDED APPROACH FOR AN
IT PROJECT MANAGEMENT OFFICE (PMO)
ROLES AND RESPONSIBILITIES
USING THE ASAP (ACCELERATED SAP) METHODOLOGY
FOR A SYSTEMS INTEGRATION (SI) PROJECT
(IT 2700-XX V 0.1 DRAFT: FOR DISCUSSION PURPOSES)
PRESENTATION
as of: <date>
Prepared for:
<Client>
Prepared By:
David Niles; Integration Programme Manager
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH 1

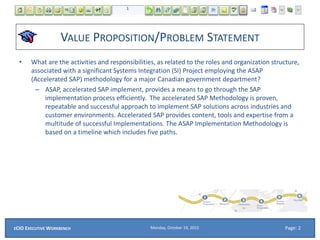

2. VALUE PROPOSITION/PROBLEM STATEMENT
• What are the activities and responsibilities, as related to the roles and organization structure,
associated with a significant Systems Integration (SI) Project employing the ASAP
(Accelerated SAP) methodology for a major Canadian government department?
– ASAP, accelerated SAP implement, provides a means to go through the SAP
implementation process efficiently. The accelerated SAP Methodology is proven,
repeatable and successful approach to implement SAP solutions across industries and
customer environments. Accelerated SAP provides content, tools and expertise from a
multitude of successful Implementations. The ASAP Implementation Methodology is
based on a timeline which includes five paths.
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page: 2

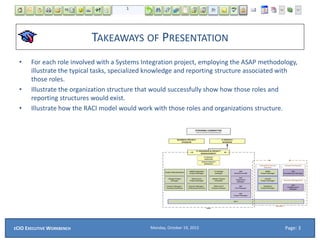

3. TAKEAWAYS OF PRESENTATION
• For each role involved with a Systems Integration project, employing the ASAP methodology,
illustrate the typical tasks, specialized knowledge and reporting structure associated with
those roles.
• Illustrate the organization structure that would successfully show how those roles and
reporting structures would exist.
• Illustrate how the RACI model would work with those roles and organizations structure.
Page: 3Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH

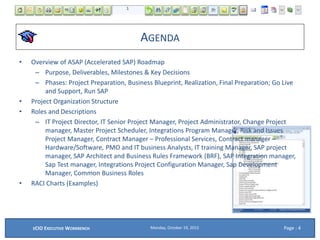

4. AGENDA
• Overview of ASAP (Accelerated SAP) Roadmap
– Purpose, Deliverables, Milestones & Key Decisions
– Phases: Project Preparation, Business Blueprint, Realization, Final Preparation; Go Live
and Support, Run SAP
• Project Organization Structure
• Roles and Descriptions
– IT Project Director, IT Senior Project Manager, Project Administrator, Change Project
manager, Master Project Scheduler, Integrations Program Manager, Risk and Issues
Project Manager, Contract Manager – Professional Services, Contract manager –
Hardware/Software, PMO and IT business Analysts, IT training Manager, SAP project
manager, SAP Architect and Business Rules Framework (BRF), SAP Integration manager,
Sap Test manager, Integrations Project Configuration Manager, Sap Development
Manager, Common Business Roles
• RACI Charts (Examples)
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 4

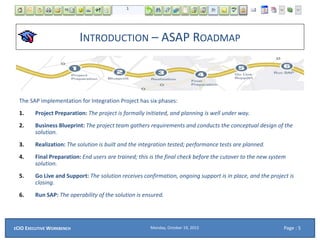

5. INTRODUCTION – ASAP ROADMAP
The SAP implementation for Integration Project has six phases:
1. Project Preparation: The project is formally initiated, and planning is well under way.
2. Business Blueprint: The project team gathers requirements and conducts the conceptual design of the
solution.
3. Realization: The solution is built and the integration tested; performance tests are planned.
4. Final Preparation: End users are trained; this is the final check before the cutover to the new system
solution.
5. Go Live and Support: The solution receives confirmation, ongoing support is in place, and the project is
closing.
6. Run SAP: The operability of the solution is ensured.
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 5

6. INFORMATION COLLECTED FOR EACH ASAP PHASE
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 6
Purpose and Description
Milestones and Key Decisions
Deliverables

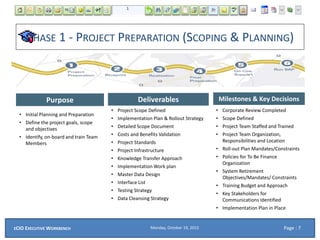

7. Purpose
• Initial Planning and Preparation
• Define the project goals, scope
and objectives
• Identify, on-board and train Team
Members
Deliverables
• Project Scope Defined
• Implementation Plan & Rollout Strategy
• Detailed Scope Document
• Costs and Benefits Validation
• Project Standards
• Project Infrastructure
• Knowledge Transfer Approach
• Implementation Work plan
• Master Data Design
• Interface List
• Testing Strategy
• Data Cleansing Strategy
Milestones & Key Decisions
• Corporate Review Completed
• Scope Defined
• Project Team Staffed and Trained
• Project Team Organization,
Responsibilities and Location
• Roll-out Plan Mandates/Constraints
• Policies for To Be Finance
Organization
• System Retirement
Objectives/Mandates/ Constraints
• Training Budget and Approach
• Key Stakeholders for
Communications Identified
• Implementation Plan in Place
PHASE 1 - PROJECT PREPARATION (SCOPING & PLANNING)
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 7

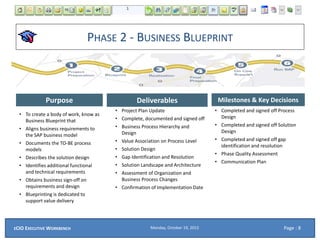

8. PHASE 2 - BUSINESS BLUEPRINT
Purpose
• To create a body of work, know as
Business Blueprint that
• Aligns business requirements to
the SAP business model
• Documents the TO-BE process
models
• Describes the solution design
• Identifies additional functional
and technical requirements
• Obtains business sign-off on
requirements and design
• Blueprinting is dedicated to
support value delivery
Deliverables
• Project Plan Update
• Complete, documented and signed off
• Business Process Hierarchy and
Design
• Value Association on Process Level
• Solution Design
• Gap Identification and Resolution
• Solution Landscape and Architecture
• Assessment of Organization and
Business Process Changes
• Confirmation of Implementation Date
Milestones & Key Decisions
• Completed and signed off Process
Design
• Completed and signed off Solution
Design
• Completed and signed off gap
identification and resolution
• Phase Quality Assessment
• Communication Plan
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 8

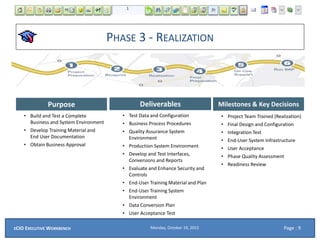

9. PHASE 3 - REALIZATION
DeliverablesPurpose
• Build and Test a Complete
Business and System Environment
• Develop Training Material and
End User Documentation
• Obtain Business Approval
• Test Data and Configuration
• Business Process Procedures
• Quality Assurance System
Environment
• Production System Environment
• Develop and Test Interfaces,
Conversions and Reports
• Evaluate and Enhance Security and
Controls
• End-User Training Material and Plan
• End-User Training System
Environment
• Data Conversion Plan
• User Acceptance Test
Milestones & Key Decisions
• Project Team Trained (Realization)
• Final Design and Configuration
• Integration Test
• End-User System Infrastructure
• User Acceptance
• Phase Quality Assessment
• Readiness Review
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 9

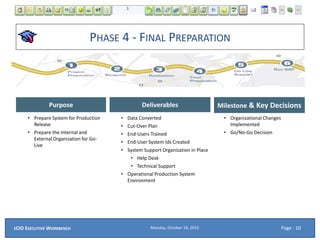

10. PHASE 4 - FINAL PREPARATION
DeliverablesPurpose
• Prepare System for Production
Release
• Prepare the Internal and
External Organization for Go-
Live
• Data Converted
• Cut-Over Plan
• End-Users Trained
• End-User System Ids Created
• System Support Organization in Place
• Help Desk
• Technical Support
• Operational Production System
Environment
Milestone & Key Decisions
• Organizational Changes
Implemented
• Go/No-Go Decision
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 10
11. PHASE 5 - GO-LIVE AND SUPPORT
DeliverablesPurpose
• Business Owns and Executes New
Business Processes and Systems
• Monitor Business Process Results
• Monitor Production Environment
• Establish Center of Excellence for
Support and Enhancements
• Live Production Environment
• Operational Help Desk
• Cut-Over and Conversion Activities
Completed
• Post Go-Live End-User Training
• Updated Business Case
• Lessons Learned
• Go-Live
• Project Close
Milestones & Key Decisions
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 11
12. DeliverablesPurpose
• Run implemented SAP solution
• Optimize solution operation by
implementing SAP Operation
standards
• Assessment of Operation Standards for
optimize solution operation
• Identify scope
• Setup project schedule for
implementing
• For each relevant Operation Standard
• Design of processes, organization
and roles, blueprint for tool usage
• Setup of processes, organization and
roles, tool setup
• Transition into production incl.
training and rollout
• Operating
• Identification of Operation
Standards for optimize solution
operation
• Design, Setup and Operation of
SAP Operations Standards
• Tool implementation (mostly SAP
Solution Manager scenarios for
operation)
Milestones & Key Decisions
PHASE 6 – RUN SAP
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 12
13. PROPOSED IT PROJECT MANAGEMENT OFFICE
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 13
14. INFORMATION COLLECTED FOR EACH ROLE
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 14
Corresponding Business Role
Description, Responsibilities, Tasks Performed,
Reporting Relationship, Specialized Knowledge
(e.g. Systems Integration Program Manager)

15. IT PROJECT DIRECTOR
–Responsibilities:
• The IT Project Director is the focal point between the Business Client, Operation Directors and ISTB Directors
• The IT Project Director is the single point of contact for Integration Project / Project Status Reporting to the Business
Client, Executive Management and Steering Committee
–Tasks:
• Has a demonstrable interest in the outcome of the project and is responsible for securing spending authority and
resources for the project.
• Leverages relationships with Business Client Executive Management, Functional Directors, IT Directors and
stakeholders/partners
• Work with Business Clients as a key and influential member of their business planning teams to ensure a continuing
delivery of outcomes through solution and IT delivery teams
• Work closely with the Program Sponsors, Steering Committee and Executive Boards to facilitate decisions necessary for
program delivery.
• Translate generalized Business Client business goals and objectives into concrete program strategy and tactical plans.
• Evaluate complex IT Solutions accurately and identify viable solutions that create successful outcome for the Business
Client.
• Resolve political, resource, budgeting, change, risk and legal issues affecting the program.
• Proactively manage the Senior Project Manager to secure Business Client success story.
• Serve as mentor / advisor / decision-maker to the delivery managers and actively resolve issues related to corporate
politics, external politics, client relations, project quality, and project risk.
–Special Knowledge:
• Substantial knowledge in project management methodology and long term experience in managing large scale projects
–Reporting to: Steering Committee, IT Project Sponsor, Executive Board
–Corresponding Business Client Role: Business Client Program Director(s)
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 15
16. IT SENIOR PROJECT MANAGER
–Responsibilities:
• The IT Senior Project Manager is responsible for the day to day management of the Project Management Office to ensure that a
standard project management framework is implemented for the Integration Project / project and ensuring compliance to project
management principles throughout the project lifecycle
–Tasks:
• Manages and implements Project Management disciplines within the Integration Project / IT PMO
• Prepares integrated approaches for all Integration Project / project management deliverables
• Prepares dashboards and financial data for IT Project Director
• Managed the day to day work packages and assignments for the Project Management Office
• Manages a team of professional project managers to ensure an integrated approach for change, risk, issue, schedule, financial,
quality, integration, scope, resource planning and procurement (contract) management
• Manages relationships between Delivery Project Managers and PMO Project Managers to attain input and updates for project
reporting
• Ensures appropriate levels of capacity during project execution
• Manages and provides timely and relevant communications to the IT Project Director, allowing the IT Project Director to keep
stakeholders informed of progress and issues in order to manage expectations on all project requirements and deliverables
• Ensures consistency in messaging on communication of project information
• Manages and communicates a clear vision of the Business Clients’ project’s objectives, and motivates the project managers to achieve
them
• Creates a project environment that enables peak performance by project managers
• Manages the financial aspects of the project: budgeting and estimate to actual and variance
• Ensures proper use of project management methodology, standards, tools, processes and procedures
• Coaches to clarify work packages and deliverables
–Special Knowledge:
• Substantial knowledge in project management methodology and experience in managing large scale Major Crown Projects
• Substantial knowledge in establishing a PMO for IT Project Delivery
–Reporting to: IT Project Director
–Corresponding Business Client Role: Business Client Senior Project Manager
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 16
17. PROJECT ADMINISTRATOR
–Responsibilities:
• The Project Administrator is responsible for the professional operation of the project office
regarding to the following tasks.
–Tasks:
• Facilitate meetings for project team including co-ordination of project team meetings and
external events.
• Book meeting rooms / venues for the team.
• Record and maintain Action Items and Records of Decision from meetings and disseminate the
meeting records to all stakeholders.
• Collect and distribute information accordingly to respective team members.
• Prepares all necessary paperwork to attain new network accounts, building access passes and
workstations for new consultants to the project
• Content-related tasks such as presentation preparation for team or Business Client meetings.
• Support the Senior Project Manager by managing the project library
• Maintains and updates the Integration Project IT PMO Confluence site
–Special Knowledge:
• Extensive experience with administrative services in the GoC
• Experience supporting Project Managers in a multi-million dollar project environment
–Reporting to: Senior Project Manager
–Corresponding Business Client Role: Business Administrator
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 17
18. CHANGE PROJECT MANAGER
–Responsibilities:
• The Change Project Manager is responsible for
–Tasks:
• Manages the timely preparation of the change management components
• Lead development of an overall Change Management strategy and communications plan
• Assist the sponsoring leaders to align on the benefits, goals, metrics and accountabilities
• Assist business unit managers to own the success of the implementation and to drive the realization
of benefits.
• Be an active, visible leadership from the executive level (project sponsor and steering committee) is
essential for a successful, sustained effort to develop the system.
• Assist (SAP) Business Team in changes to the organization structure and/or job roles. Stakeholder
analysis and impact assessment
• Establish specific roles and responsibilities, expectations etc. of team members to assist
Stakeholders in business transformation
• Plan for Organizational readiness related to non-SAP changes (such as new non-SAP skill
development and redeployment)
• Leadership alignment and commitment and Organizational readiness to use /Integration Project
–Special Knowledge:
–Reporting to: Senior Project Manager
–Corresponding Business Client Role: Business Administrator
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 18
19. MASTER PROJECT SCHEDULER
–Responsibilities:
• The Master Project Scheduler ensures that the WBS and
–Tasks:
• Working with OCI’s, Delivery Managers and Business Clients, develops Work Breakdown Structures (WBS) and timelines/milestones for
project deliverables
• Working with OCI’s, Delivery Managers and Business Clients, produces project activity and tasks based on timelines and milestones
and WBS
• Produces reports and identifies scheduling and/or dependency issues.
• Assists in schedule co-ordination efforts with internal and external project stakeholders.
• Maintains and updates relevant project scheduling information
• Develops and maintains a detailed project schedule for all areas of the project
• Closely monitors and coordinates schedule updates
• Acts as a subject matter expert and resource to project managers, providing guidance and direction related to managing links between
schedules and task prioritization; provide hands-on schedule management support as necessary
• Conducts and provides critical path analysis and reports on the integrated project schedule’s critical paths
• Develops effective mechanisms for communicating any schedule shifts to management
• Advises and updates project management about emerging risks to key milestones
• Suggests new reports and tools to manage critical path tasks across the project
• Develops and implements strategy to introduce scheduling best practices, including metrics
• Develops and manages the creation of presentations, schedules, and other program and project oversight tools for project, program,
and executive management;
• Provide schedule snapshots
–Special Knowledge:
• Substantial knowledge and experience in integrated project scheduling (IT and Business)
–Reporting to: Senior Project Manager
–Corresponding Business Client Role: Business Client Scheduler
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 19
20. INTEGRATION PROGRAMME MANAGER
– Responsibilities:
• Develops a comprehensive IT Project Integration document which highlights the start and end states for all IT related
system touch points for Integration Project
– Tasks:
• Develops a comprehensive IT Project Integration document which highlights the start and end states for all IT related
system touch points for Integration Project / and legacy systems (including systems earmarked for decommission)
• Works with the IT Architecture, IT Infrastructure, Business Client, and other Solutions Development and Solutions
Planning teams to align plans for the Integration Project / solution with Integration solution planning.
• Works with the IT OCIs to provide input into an actionable IT roadmap that establishes the foundation of work that the
development teams will deliver.
• Understand and analyze database and reporting requirements for Integration Project / and system decommissions
• Ensure that work packages are identified for all integration points with upstream and downstream systems
• Work with OCIs to develop and implement process improvements to enhance integration within a high level of integrity
to handle sensitive and confidential information
• Ensure coverage of work packages for the IT work (design, construction, quality assurance, testing and deployment)
associated with integration middleware solutions is contained within the Integration Project / project schedule
• Works closely with the Service Delivery teams to ensure adequate transitions/interconnectivity are in place before
legacy system functionality is turned off (decommission)
– Special Knowledge:
• Extensive experience with software and systems integration projects in the GoC
– Reporting to: Senior Project Manager
– Corresponding Business Client Role: Business Integration Manager
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 20
21. RISK AND ISSUE PROJECT MANAGER
–Responsibilities:
• The Risk and Issue Project Manager is responsible for ensuring that risk is minimized on a project and that issues
are resolved in a timely manner.
–Tasks:
• Delivers high quality risk and issue management services in a focused and timely manner through the implementation of
industry best practices
• Plans, designs and implements risk and issue management processes for the Integration Project / project
• Develops clear processes and procedures to be used by managers to manage risks and issues for Integration Project /
• Provides a simple approach to qualitative and quantitative risk management for the Integration Project / project that can
be scaled and used by other projects, if required
• Analyses, daily, the risk log and issue log for resolution, mitigation or escalation and reports on trends, projections or
impacts on current risk status
• Works with the Project Scheduler to ensure that activity associated with risk mitigation is captured in the project schedule
with defined delivery dates
• Provides support, education, and training to project team members to build awareness of risk and issue management
• Integrates project risks and issues into one instance for the Integration Project / PMO and ensures input and update from
all Delivery Project Managers on an ongoing basis.
• Delivers Risk and Issue reports to the Senior Project Manager weekly
• Prepares Risk Matrices and other graphical diagrams as required by the PMO
–Special Knowledge:
• Extensive experience with project risk and issue management in the GoC
–Reporting to: Senior Project Manager
–Corresponding Business Client Role: Business Risk Manager
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 21
22. CONTRACT MANAGER – PROFESSIONAL SERVICES
–Responsibilities:
• The Contract Manager – Professional Services is responsible for the preparation and processing of Integration Project IT professional
services contracting requirements.
–Tasks:
Drafting, evaluating and execution of professional services contracts
Prepares all documentation regarding RFPs
Serves as one of the single point of contact for Integration Project IT PMO on contractual matters regarding professional services.
Acts as the contractual “middleman” between CBSA and Vendors/Suppliers for professional services.
Manages third party RFP developers hired by Integration Project to assist in RFP preparations.
Maintains contractual records and documentation, such as receipt and control of all contract correspondence, Business Client
contact information sheets, contractual changes, status reports and other documents for the project.
As needed, provide guidance on contract matters to project managers, including training to new project managers and other
employees in contracting procedures.
Develop and implement procedures for contract management and administration in compliance with company policy.
Work with the Risk Manager to identify any contracting risks or risks associated with attaining specific professional services
required for project success
Ensure project library contains a copy of the signed contract for project records
Working with the Senior Project Manager, ensure that contract closures, renewals and revisions are conducted in a timely manner.
–Special Knowledge:
• GoC Contracting for Professional Services
• CBSA Contracting Policies
–Reporting to: Senior Project Manager
–Corresponding Business Client Role: Business Client Contracting Officer
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 22
23. CONTRACT MANAGER – HARDWARE/SOFTWARE
–Responsibilities:
• The Contract Manager – Hardware/Software is responsible for the preparation and processing of Integration Project IT hardware and
software license procurement.
–Tasks:
Drafting, evaluating and execution of COTS, hardware or other related software licenses contracts
Prepares all documentation regarding RFPs
Serves as the single point of contact for Integration Project IT PMO on contractual matters regarding COTS, hardware/software.
Acts as the contractual “middleman” between CBSA and Vendors/Suppliers for COTS, hardware/software.
Maintains contractual records and documentation, such as receipt and control of all contract correspondence, Business Client
contact information sheets, contractual changes, status reports and other documents for the project.
As needed, provide guidance on contract matters to project managers, including training to new project managers and other
employees in contracting procedures.
Develop and implement procedures for contract management and administration in compliance with company policy.
Work with the Risk Manager to identify any contracting risks or risks associated with attaining specific COTS, hardware or software
licenses required for project success (including all SAP procurement)
Ensure project library contains a copy of the signed contract for project records
Working with the Senior Project Manager, ensure that contract maintenance agreements, renewals and revisions are conducted in
a timely manner.
–Special Knowledge:
• GoC Contracting for COTS, Hardware & Software
• CBSA Contracting Policies
–Reporting to: Senior Project Manager
–Corresponding Business Client Role: Business Client Contracting Officer
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 23
24. PMO AND IT BUSINESS ANALYST
–Responsibilities:
• The Process & Procedure Writer is responsible for documenting the processes adopted by the PMO and supports all the Project
Managers with preparation of project documentation to adhere to the processes and procedures.
–Tasks:
• Working with the Senior Project Manger, Project Director and Project Managers, develops workflow diagrams to provide a
graphical representation of project management processes from inception of documentation to reviews to approvals and execution
• Develops standardized processes to be followed and provides useful tools and appropriate training for these tools preventing each project
manager from establishing the process independently for each project
• Provide support and tools to Project Managers to enable them to start up sub-projects quickly with less time wasted planning and
documenting steps
• Continuous maintenance of a knowledge bank of project management information based on industry-wide and company best
practices.
• Helps teams perform best practices and methodologies.
• Tracks and records lessons learned from sub-projects in order to learn from them and implement tools and techniques to mitigate
the negative lessons
• Develops and maintains an open collection of the PMO policies, procedures, templates, guidelines, and project documentation.
–Special Knowledge:
• Extensive experience with implementing ITIL framework in the GoC
• TBS EMF and MAF
• ITIL Service Management and Service Delivery and Project Management 9 areas of knowledge
–Reporting to: Senior Project Manager
–Corresponding Business Client Role: Business Client Project Manager
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 24
25. IT TRAINING MANAGER
–Responsibilities:
• The Training Manager is responsible for leading the development of an overall training strategy and training curriculum to address the
project team learning needs and product end-state end user training.
–Tasks:
• Prepares and designs the training scenarios and content
• Prepares supporting documentation
• Provides project team and end user training during implementation of project on the new system
• Service during the initial implementation and possibly on an ongoing basis
• Leads the development of an overall training strategy and training curriculum
• Establishes training plans for each of the releases and works with the Business Client Training Manager to schedule Train-the-
Trainer sessions
• Facilitates and arrange for classroom space for external training vendors to provide training to project team members
• Leads, reviews and mentors the development of all training materials for end user delivery
• Prepares CBSA trainers to deliver the course material and offers additional training if required
• Works closely with CBSA training and communications liaisons and SMEs
• Leads the development of a comprehensive knowledge transfer plan to CBSA staff
• Works with the SAP Project Manager to identify training related activities and tasks, and to provide training activity updates
• Manages the training strategy and curriculum development
• Coordinates project team training and knowledge transfer activities
–Special Knowledge:
• Extensive knowledge and experience with SAP and PSCD implementations
–Reporting to: Senior Project Manager
–Corresponding Business Client Role: Business Client Training Manager, Business Client LoB Manager
26. SAP PROJECT MANAGER
–Responsibilities:
• Responsible for defining, planning, tracking and managing SAP solutions and identifying key resources and providing the direction they
require in order to meet defined objectives
–Tasks:
• Facilitate, document and assist the Configuration and Development managers with SAP project preparation activities for every project
phase
• Monitors, maintains and reports on the day to day project execution of the SAP Integration Project work
• Responsible for development of SAP project planning activities and manages the execution of the SAP solution delivery according to
plan
• Identifies work packages and prepares project schedule to address SAP solution delivery and integrates into the Integration Project /
Master Project Schedule
• Provides advice to Line of Business (LOB) managers and development/configuration managers
• Responsible for the identification, documentation and escalation of SAP solution delivery risks and issues to the Risk Manager,
establishes contingency and mitigation plans and identifies trigger events
• Reviews regularly outstanding action items, issues and risk that require action by the SAP project team and ensures that activity is
scheduled and integrated into the SAP delivery schedule
• Co-ordinates quality assurance with the SAP Integration Manager and ensures performance measurement
• Assesses SAP work progress and project performance and identifies work activities and potential delays/accelerations along the critical
path
• Applies ASAP methodology
• Proactively identifies changes in work scope to the Change Manager and ensures appropriate planning measures are taken to reassess
and amend the scope of work requirements, budget and timeline.
• Coaches SAP project team members to clarify assignments and deliverables; reviews quality of work and manages integration of team
members’ work
–Special Knowledge:
• Extensive experience managing SAP Solutions and using ASAP Methodology
• Experience in project management methodology and experience in managing large scale Major Crown Projects
–Reporting to: Senior: Senior Project Manager
–Corresponding Business Client role: Business Client Project Manager
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 26
27. SAP ARCHITECT & BUSINESS RULES FRAMEWORK (BRF)
–Responsibilities:
• The SAP Architect is responsible for the SOA transition aspects, strategic system landscape, interoperability and design of
SAP solutions from start to end.
–Tasks:
• Architects the entire SAP solution and brings high technological experience for SAP based solutions
• Brings a firm understanding on the SAP technology platform product capabilities and architecture
• Serves as primary architect of the value attainment model for given SAP-focused transformational efforts
• Links value drivers in the transformational business case with the business blueprint
• Develops the value scorecard and educating key business process owners and program management on how to measure
and monitor value achievement through post go live realization
• Works with Functional Analysis team to drive blueprints for development requirements
• Acts as a sounding board for SAP technological strategies and provides technical direction for the SAP solutions
• Consults and mentors technical resources concerning methods, procedures, and standards to be used during design,
development, and unit testing phases of system development projects
• Assures that SOA concepts are defined correctly and works with the SAP project team during the definition and
implementation of the overall solution
• Guides the business, functional and technical team with business rules formulation requirements into Integration Project SAP solution.
• Assist in defining and setting up BRF based on the technical requirements from detail design and facilitate discussion around best
practices.
• Assist the baseline BRF configuration to support the most effective and efficient processing in SAP for Collections and Assessments.
• Guide the Integration Project team on the Design, Build and Test activities for Integration Project , including demonstration/proof of
concept of SAP using BRF Plus.
–Reporting to: Senior Project Manager
–corresponding Business Client Role: Business Client LoB Manager
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 27
28. SAP INTEGRATION MANAGER
–Responsibilities:
• The SAP Integration Manager is the focal point of contact between Business and IT and, working with the SAP Project
Manager and SAP Architect, ensures a consistent and succinct approach to delivering end state SAP solutions.
–Tasks:
• Leads/Advises design across Business and IT Functional and Development teams
• Provides the Business Client and IT Functional and Development SAP PSCD insight and guidance throughout the Project
Preparation, Blueprint, and Realization project phases
• Advises the SAP Project Manager, SAP Configuration Manager and the SAP Development Manager on the development
and delivery of all in scope business process deliverables
• Works with the SAP Project Manager to ensure that the work modules associated with configuration, development and
testing of the business process solution (process, ERP and related bolt-ons) are incorporated into the project schedule
• Applies ASAP methodology to all SAP related Integration Project implementations
• Co-ordinates and advises on priorities across Business and IT Functional and Development teams
• Resolves cross-team design issues
• Working with the SAP PM, defines deliverable standards and quality assurance performance measures
• Responsible for the development of an integrated SAP solution plan for each of the business processes.
–Special Knowledge:
• Strong interpersonal skills and extensive experience interpreting Business Clients requirements and align to SAP offerings
• Strong understanding of capabilities and pitfalls of legacy system integration and transition
• Extensive experience with SAP PSC platform and interfaces.
–Reporting to: Senior Project Manager
–Corresponding Business Client Role: Business Client LoB Manager
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 28
29. SAP TEST MANAGER
–Responsibilities:
• The Test manager is responsible for reaching the defined and agreed test goals.
–Tasks:
• Setting up a test concept, design of test strategy according the quality goals, test activities and responsibilities, test stages
and methods, test case design
• Define requirements and coordinate setup of the technical test environment, test data management, test tool selection
• Review of project deliverables (test concept, test cases, scripts, test documentation, test reporting, error handling)
• Successful identifying, conception and monitoring of the execution of test processes/projects
• Monitoring and controlling test process quality and results
• Conception and execution of non functional tests (e.g. performance)
• Successful execution of test services
• Guidance and coaching by defining documentation and conventions
• Coordination and administration of all test activities
• Issue and error handling and reporting
• Automation of regression tests
–Special Knowledge:
• Substantial knowledge and experience in testing
• Knowledge of integration between applications and external systems.
• Business Knowledge
–Reporting to: Senior Project Manager
–Corresponding Business Client Role: Business Client LoB Manager, SAP Test Coordinators
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 29
30. INTEGRATION PROJECT CONFIGURATION MANAGER
–Responsibilities:
• The Integration Project Configuration Manager manages the efforts of the Functional team and Blueprinting.
–Tasks:
• Manages the work business modules associated with the blueprinting and configuration of the SAP PSCD solutions for Integration
Project .
• Manages the work associated with the development of individual business process solutions and ensure Business Client
acceptance
• Manages the functional analysts on day to day work
• Reviews and approves deliverables for the Blueprint processes
• Working with the SAP Project Manager and the Integration Project Project Scheduler, ensures that all work packages for
Blueprinting are identified, detailed and accounted for on the master project schedule
• Working with the SAP Project Manager, ensures that proper levels of resource loads are accounted for and financing is in place to
execute work
• Working with the SAP Project Manager, ensures that all risks and issues raised during the blueprinting process are recorded with
proper mitigation plans and incorporated into the master risk management log
• Responsible for team member direction and work priorities
• Provides operational/system up-dates to Director, Revenue Management and ensures that project status updates (schedule, cost,
scope, resources, etc) are made known to the SAP Project Manager and captured on the master reports.
–Special Knowledge:
–Reporting to: Director, Revenue Management Division
–Corresponding Business Client Role: Business Client LoB Manager
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 30
31. SAP DEVELOPMENT MANAGER
–Responsibilities:
• Responsible for all ABAP development for the SAP PSCD Integration Project solutions.
–Tasks:
• Manages the day to day operations for the SAP Competency Centre and ABAP development
team
• Defines, manages and owns the SAP development, testing and production system
environments
• Responsible for detail schedule plans for all environment build and development efforts
• Supports and manages the SAP operating system
• Supports and manages SAP system optimization
–Special Knowledge:
–Reporting to:
• Director, Commercial Systems
–Corresponding Business Client Role:
• Business Client operations department
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH
Page : 31
Page : 31
32. COMMON BUSINESS CLIENT ROLES
–According to the type of project, size, its function, there are many groups of people involved in the SAP and
non-SAP project lifecycle
–Business Client team members bring applicable business knowledge, regulatory and legislative knowledge
and expertise prevalent to the project.
–Common Business Client Roles include (but are not limited to):
• Integrated Business and IT Steering Committee
• Business Client Project Sponsor
• Business Project Director
• Project Communications Manager (external)
• Business Project Manager
• Business Team Leads / LoB Managers – Decision Maker on business process
• Project Team Members (Representatives) according to function in Business Client organization
(e.g. Business Analysts, Business SMEs, Training Specialist, Legal Advisor, Internal Auditor,
Operations, etc.)
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 32
33. RESPONSIBILITY ASSIGNMENT MATRIX (RAM)
• A responsibility assignment matrix, also known as RACI matrix or linear responsibility chart (LRC),
describes the participation by various roles in completing tasks or deliverables for a project or
business process. It is especially useful in clarifying roles and responsibilities in cross-
functional/departmental projects and processes.
• RACI is an acronym that was derived from the four key responsibilities most typically used:
– Responsible, Accountable, Consulted, and Informed.
• There is a distinction between a role and individually identified people:
– a role is a descriptor of an associated set of tasks; may be performed by many people; and one
person can perform many roles. For example, an organisation may have ten people who can
perform the role of project manager, although traditionally each project only has one project
manager at any one time; and a person who is able to perform the role of project manager
may also be able to perform the role of business analyst and tester.
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 33
34. KEY RESPONSIBILITY ROLES
• Responsible
– Those who do the work to achieve the task. There is at least one role with a participation type of
responsible, although others can be delegated to assist in the work required (see also RASCI below
for separately identifying those who participate in a supporting role).
• Accountable (also approver or final approving authority)
– The one ultimately answerable for the correct and thorough completion of the deliverable or task,
and the one who delegates the work to those responsible. In other words, an accountable must sign
off (approve) on work that responsible provides. There must be only one accountable specified for
each task or deliverable.
• Consulted (sometimes counsel)
– Those whose opinions are sought, typically subject matter experts; and with whom there is two-way
communication.
• Informed
– Those who are kept up-to-date on progress, often only on completion of the task or deliverable; and
with whom there is just one-way communication.
• Very often the role that is accountable for a task or deliverable may also be responsible for completing it
(indicated by having a role accountable for it, but no role responsible for its completion, i.e. it is implied).
Outside of this exception, it is generally recommended that each role in the project or process for each
task receive, at most, just one of the participation types. Where more than one participation type is
shown, this generally implies that participation has not yet been fully resolved, which can impede the
value of this technique in clarifying the participation of each role on each task.
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 34
35. ALTERNATIVES
There are a number of alternatives to the RACI participation types:
• RASCI : This is an expanded version of the standard RACI, less frequently known as RASIC, breaking the responsible
participation into:
– Responsible - Those responsible for the task, who ensure that it is done as per the approver
– Support -Resources allocated to responsible. Unlike consulted, who may provide input to the task, support help
complete the task.
• RACI-VS: This is an expanded version[6] of the standard RACI, with two additional participation types:
– Verifier - Those who check whether the product meets the acceptance criteria set forth in the product description.
– Signatory -Those who approve the verify decision and authorize the product hand-off. It seems to make sense that the
signatory should be the party being accountable for its success.
• CAIRO : This is an expanded version, of the standard RACI, also known as RACIO with one additional participation type.
– Out of the loop (or omitted) - Designating individuals or groups who are specifically not part of the task. Specifying
that a resource does not participate can be as beneficial to a task's completion as specifying those who do participate.
• DACI : Another version that has been used to centralize decision making, and clarify who can re-open discussions.
– Driver - A single driver of overall project like the person steering a car.
– Approver - One or more approvers who make most project decisions, and are responsible if it fails.
– Contributors - Are the worker-bees who are responsible for deliverables; and with whom there is two-way
communication.
– Informed - Those who are impacted by the project and are provided status and informed of decisions; and with whom
there is one-way communication.
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 35
36. VARIATIONS
There are also a number of variations to the meaning of RACI participation types:
• RACI (alternative scheme)
– There is an alternative coding, less widely published but used by some practitioners and process mapping
software, which modifies the application of the R and A codes of the original scheme. The overall
methodology remains the same but this alternative avoids potential confusion of the terms accountable and
responsible, which may be understood by management professionals but not always so clearly
differentiated by others:
• Responsible - Those responsible for the performance of the task. There should be exactly one person
with this assignment for each task.
• Assists - Those who assist completion of the task.
• Consulted - Those whose opinions are sought; and with whom there is two-way communication.
• Informed - Those who are kept up-to-date on progress; and with whom there is one-way
communication.
• RACI (decisions)
– This alternative is focused only on documenting who has the authority to make which decisions. May be
suitable for use within a small work group.
• Recommends - Responsible to recommend an answer to the decision.
• Approves - Authorized to approve an answer to the decision.
• Consulted - Those whose opinions are sought; and with whom there is two-way communication.,,,,
• Informed - Those who are informed after the decision is made; and with whom there is one-way
communication
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 36
37. RACI APPROACH
• The following approach was used to determine our RACI model.
– From the ASAP Roadmap presented earlier, we identified the various types of artifacts from the
“Deliverables” and “Key Milestones” sections
– Roles were identified, both from this presentation and earlier project documentation
– Each role was assigned to a representative artifact along with their RACI designation.
• The following slides show early results from this process (WIP)..
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 37
38. LIST OF ASAP ARTIFACTS WITH RACI OWNERSHIP
RACI chart is shown for
both business and
project artifacts
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 38
39. LIST OF ARTIFACTS FOR EACH ROLE
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 39
40. NEXT STEPS
• Complete the listing of artifacts and RACI assignments
• Validate the RACI model with Project Team & Business
• Assign “Names & Titles” to each of the roles
• Distribute & publish results
Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH Page : 40
41. PRESENTERS BACKGROUND
• David Niles (djn_bus@msn.com)
– Director, Systems Development
• USA Federal Government Health Care, Washington DC
– Director Enterprise Infrastructure
• Sanmina-SCI Contract Manufacturing, San Jose CA, Huntsville AL
– Director, Project Control And Service Management
• Sanmina-SCI, Chennai India Guadalajara MX
• Mergers and Acquisitions, DRP, SOX, GSC, PMO
– Sr. Director Support Services
• Burlington Coat Factory, Philadelphia PA
• Change Control, GSC, Asset Management, Field Services, Technical
Services, PMO
– Program Director, Day 2 Wipro
– Special advisor, to the CIO/COO Macmillan Publishing NYC
Page: 41Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH
42. TOOLKITS USED IN THE ASSISTANCE FOR COLLECTION OF
INFORMATION
• Mindmap
• eCIO Executive Workbench
– Toolkit and examples for all facets of the
workplace for managers, executives and
the individuals contributor
– Email me and I’ll get you a copy
Page: 42Monday, October 19, 2015ECIO EXECUTIVE WORKBENCH
