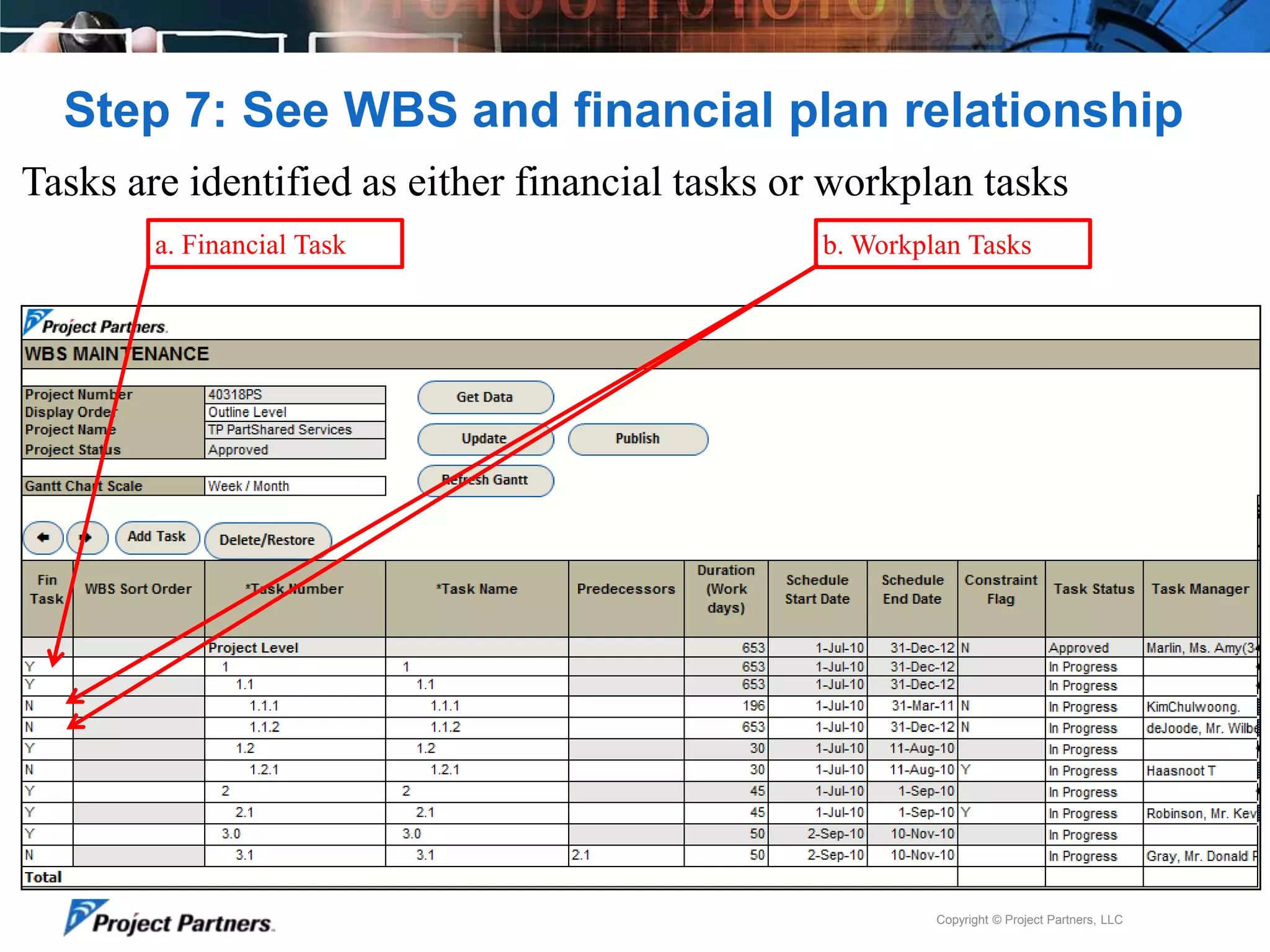

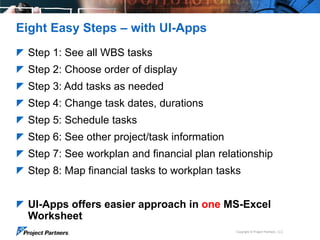

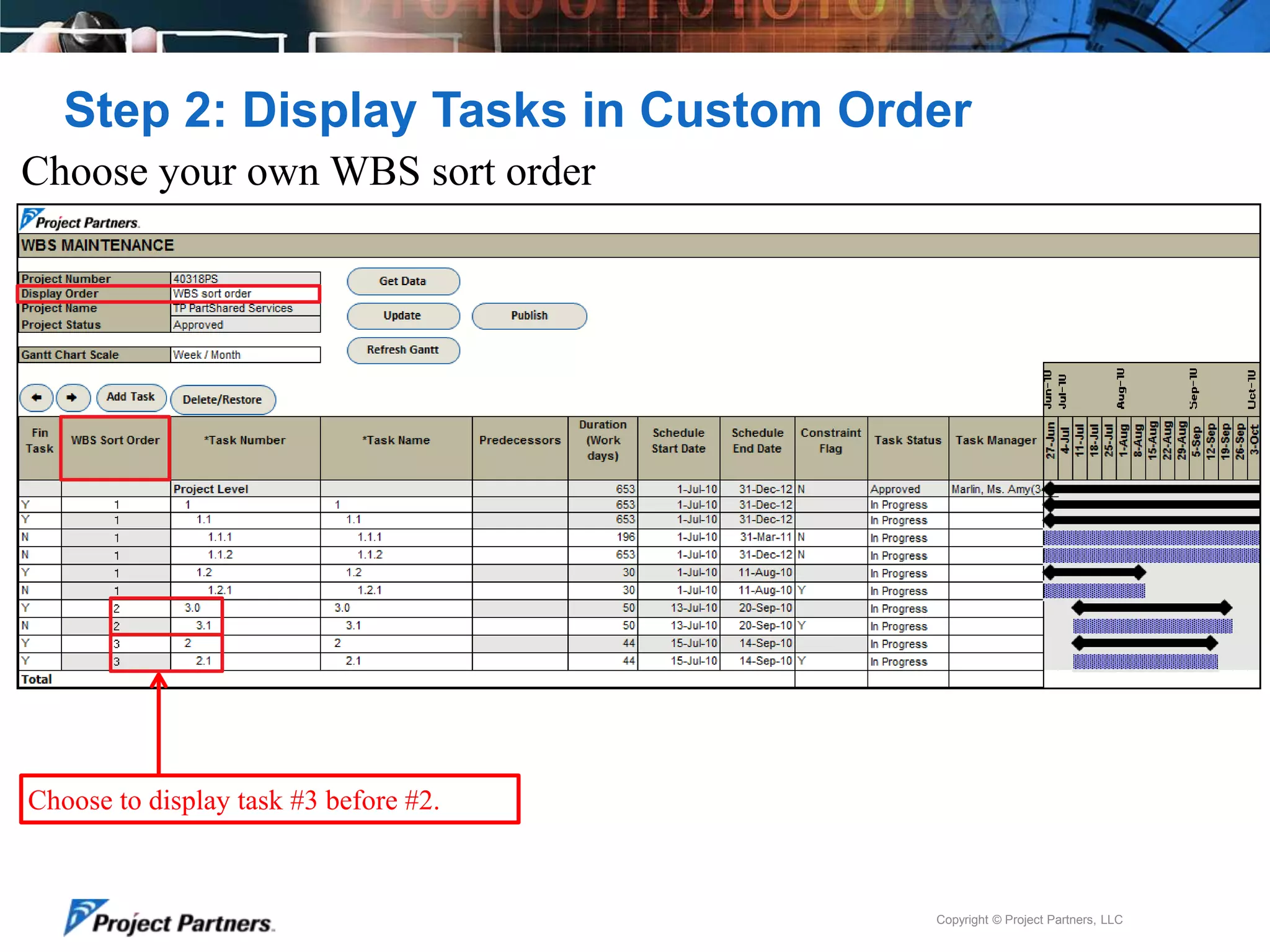

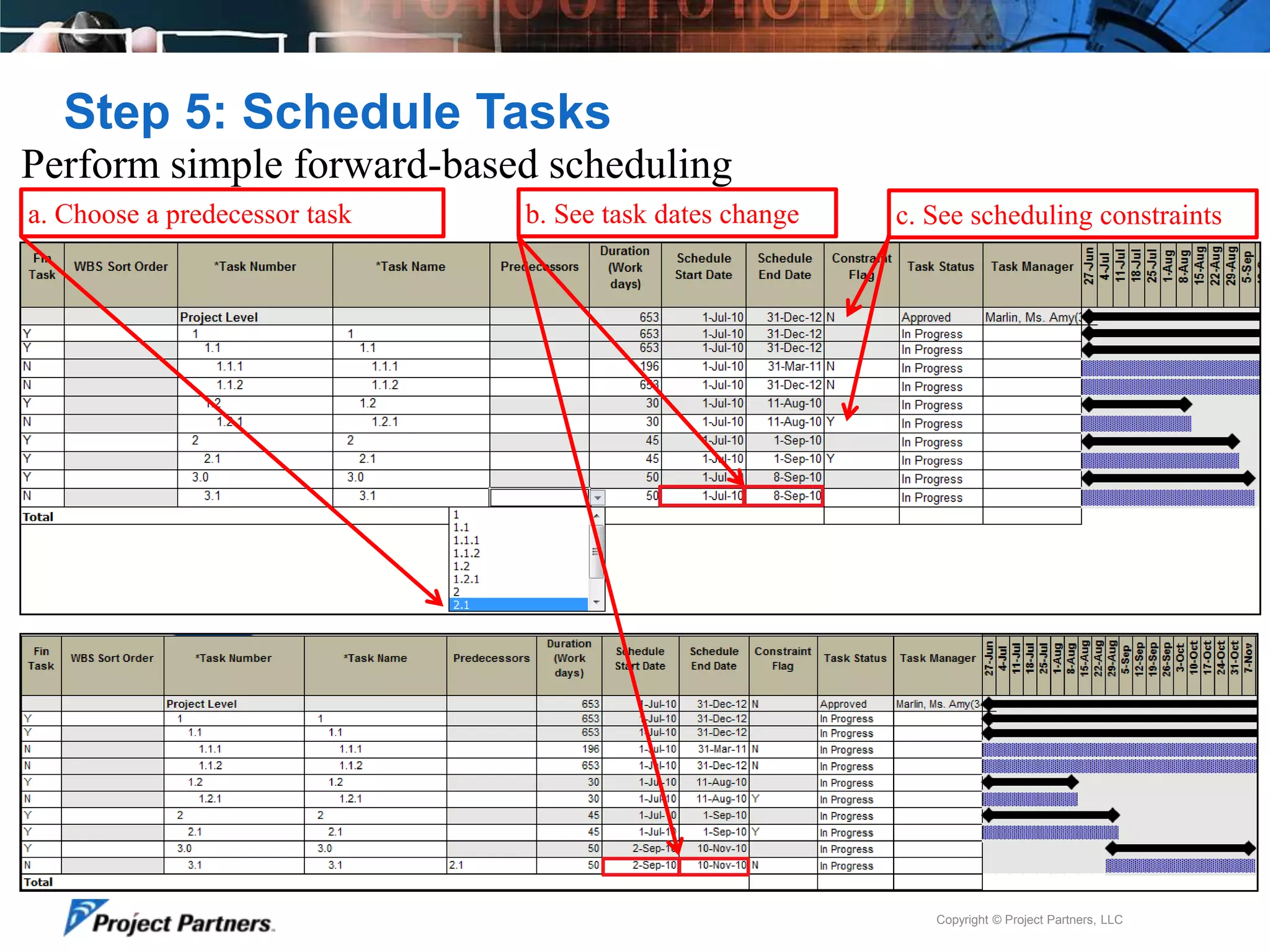

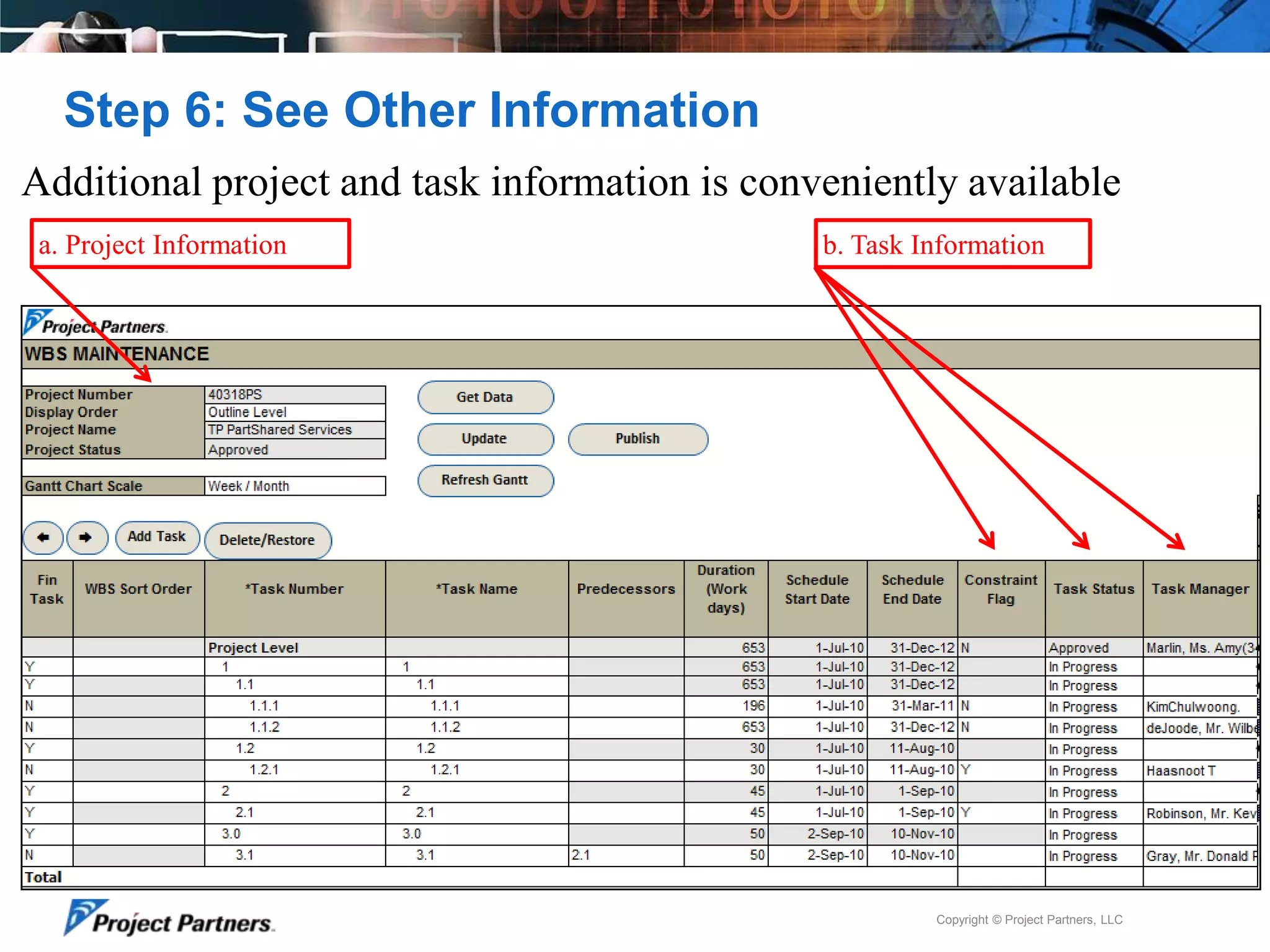

Quickly update your Project financial Forecast for your Oracle EBS Projects f...Project Partners LLC
The document describes how UI-Apps from Project Partners provides an easier approach for creating project forecasts in Oracle Projects using a single Microsoft Excel worksheet. The 8-step process allows project managers to see budget and actual amounts, add new tasks and resources, forecast estimate-to-complete amounts, see roll-ups in real-time, refresh actuals, view the total forecast plan, and compare forecast totals to original budgets. UI-Apps streamlines the project forecasting process for improved accuracy.

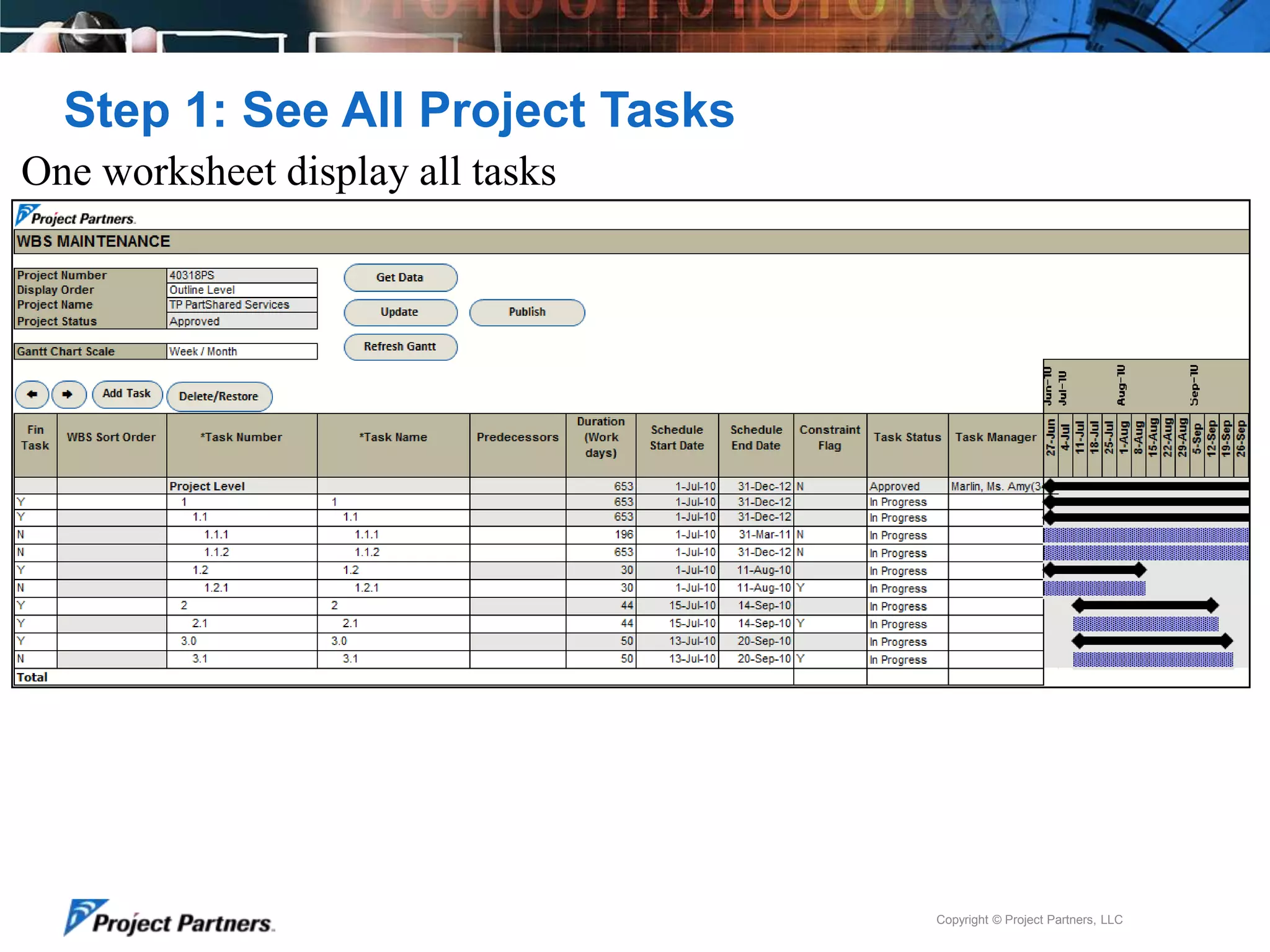

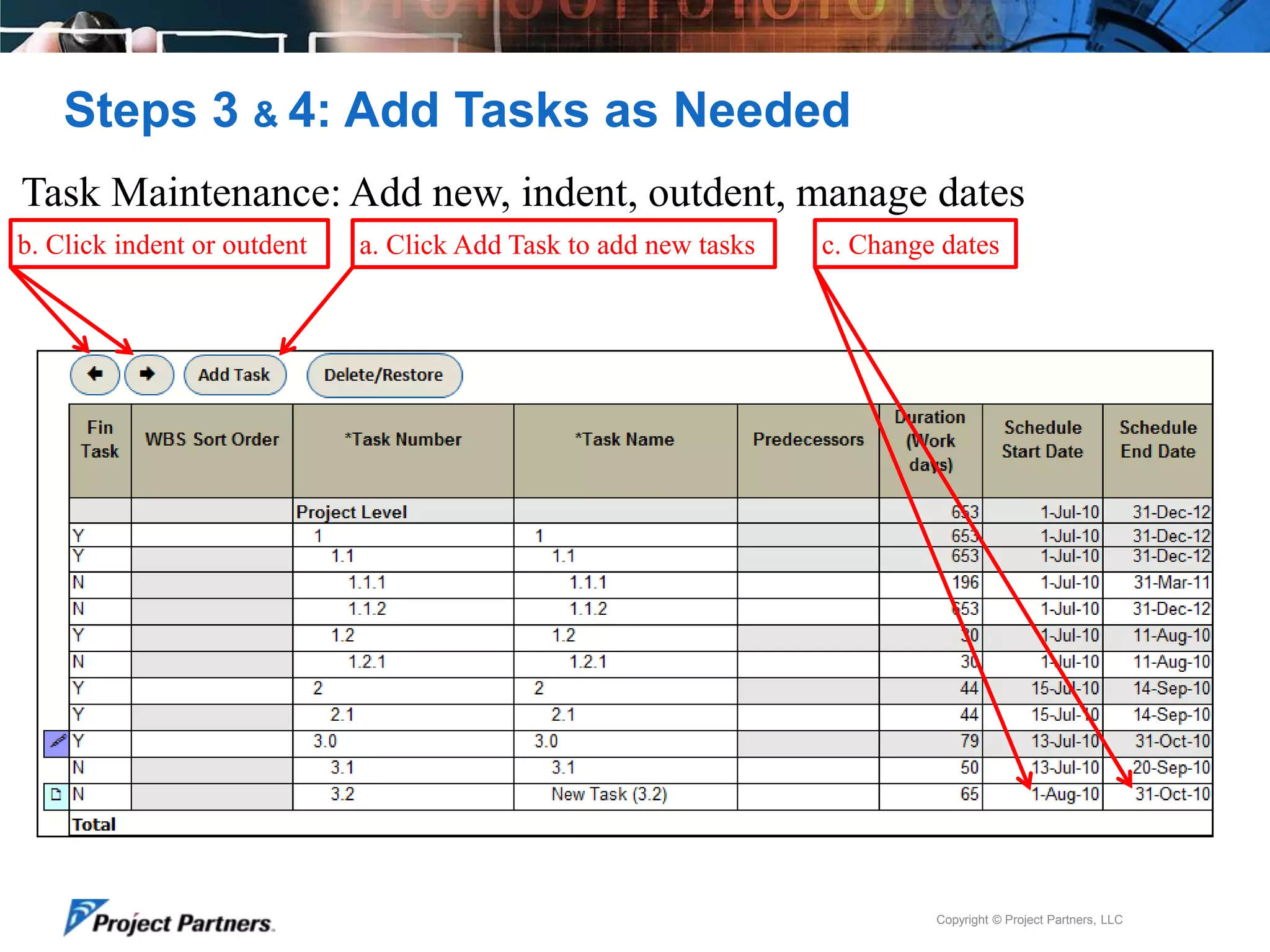

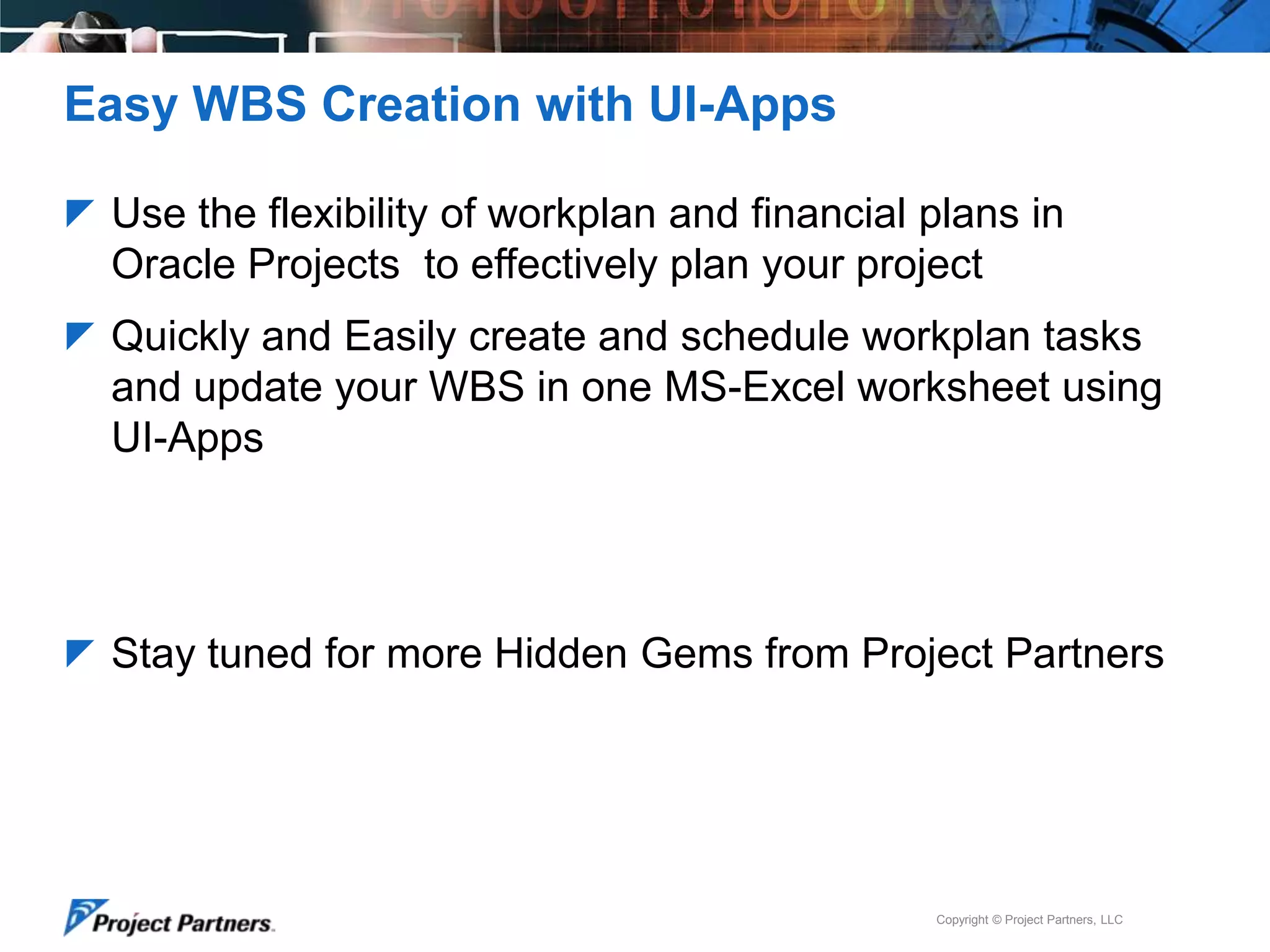

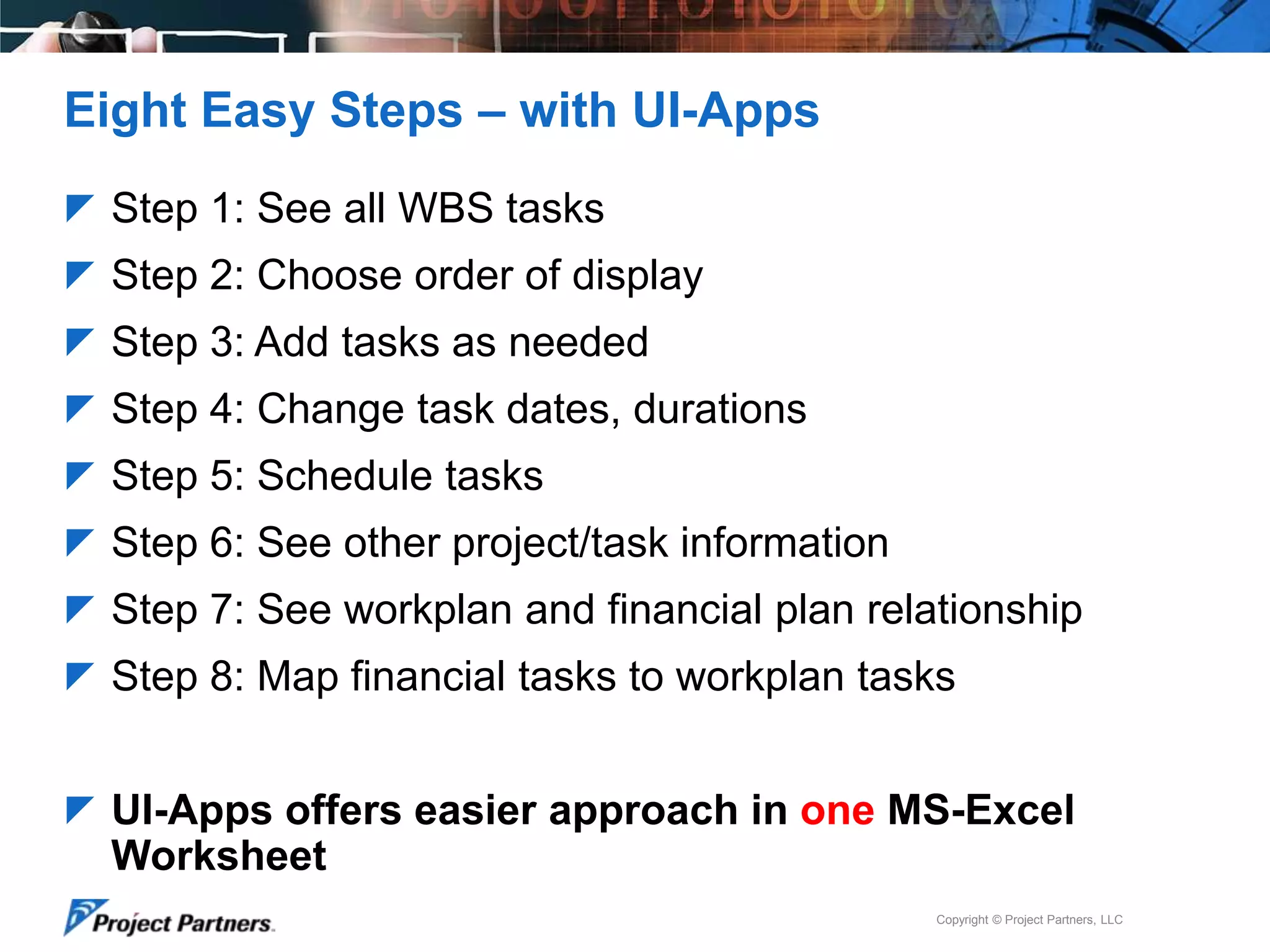

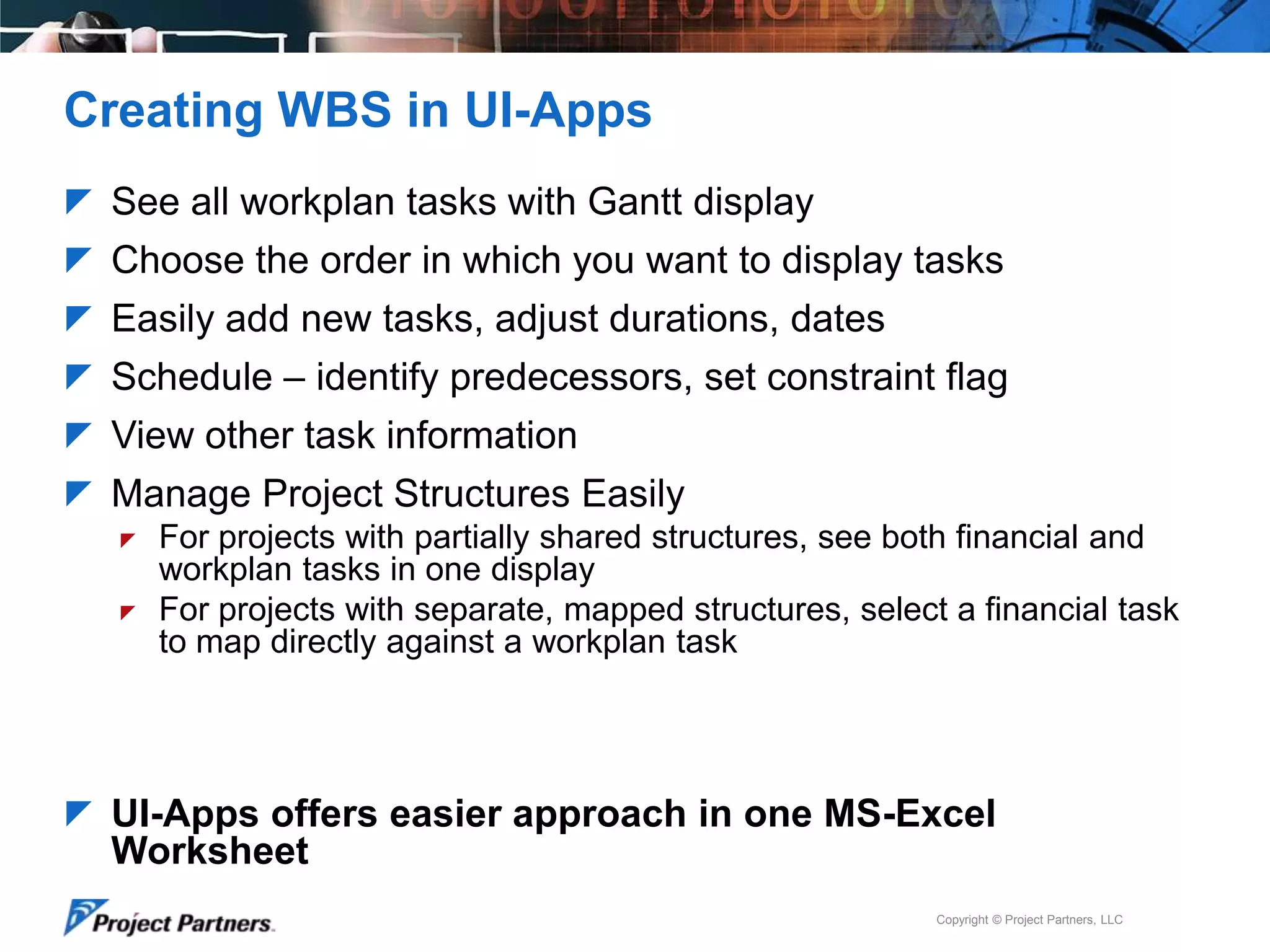

Microsoft Excel Interface for Oracle EBS Projects applications - Screenshots ...Project Partners LLC
This presentation lays out screenshots of the Project Partners User Interface Applications (UI-Apps) MS-Excel based UI for Project Managers using Oracle EBS Projects.
This document provides an overview of tricks and traps in Primavera P6 Version 7 related to bars functions. It demonstrates bar formatting issues and solutions, including how to remove relationships on baseline bars and create summary bars. It also covers topics like negative float display, summary duration calculations, and baseline bars showing when no baseline is set. Finally, it discusses techniques like critical open ends, multi-project float calculation, and using expenses to manage costs in the work breakdown structure.
This document provides a summary of a presentation on Primavera P6 Version 7 functions and techniques. The presentation covers topics such as removing float from completed activities, creating summary bars, calculating negative float, and techniques for handling activity durations with resources and cash flow with expenses. It demonstrates how to perform tasks in P6 like removing relationships from a baseline bar and provides explanations for issues like why a baseline bar may display when no baseline is set.
This document discusses the project management software Active Collab. It outlines the key features of Active Collab including management and planning, documentation, collaboration, and budgeting features. It also covers roles in Active Collab like client, manager, and administrator. Milestones, pros and cons, challenges, goals, and approaches for Active Collab are summarized. The document concludes that Active Collab compares favorably to other project management tools by automating activities like time tracking and invoicing.
Project Scheduling of a High-rise Building using Primavera P6IRJET Journal
This document summarizes a study that used Primavera P6 software to schedule the construction of a high-rise residential building project. The study collected data on the project activities and durations, then modeled the schedule in Primavera P6 to determine the critical path and optimize the timeline. Key outcomes included reducing the risk of delays and cost overruns, optimizing resource management, and generating reports to track progress against the baseline schedule. The conclusions stated that Primavera P6 is an effective tool for construction scheduling that allows linking all activities, determining float times, and monitoring scheduled versus actual progress.
This presentation provides an introduction to project structures in SAP Project Systems. It discusses how projects can be structured using work breakdown structures (WBS) and networks/activities. It then provides details on creating a WBS, including defining WBS elements and using templates. It also covers the use of system and user statuses to control the stages of a project.
The document discusses project management and how to plan and schedule projects in Microsoft Project. It defines key project management terms like tasks, resources, relationships, and views. It outlines the steps to create a new project in Microsoft Project, including setting properties, timetables, and entering tasks and durations. It describes how to visualize projects using Gantt charts, assign relationships between tasks, and format outlines and summaries. Calendar settings allow customizing work schedules for individual tasks.
4.3.2013 Tool Demo - Traditional Development RTC Planning In Context Collabor...IBM Rational
Series Name: Tool Demonstration for ALM
Wecast Title: Tool Demo - Traditional Development RTC Planning In Context Collaboration
Date: 4.3.2013
Presenter: Don Cunningham
Avoid the mistakes that break next year’s project budget reporting! Walk through the steps required to close the year with SAP’s Project Systems and Investment Management.
* Clarify the year-end role of Project Systems
* Describe two reporting methods within IM
* Explain the most efficient IM transactions
* Expand on Advance Commitment budgeting
* Identify the mistakes to avoid
How efficient is your business’ budgeting process? Indirect budgeting can be unclear, especially when it comes to understanding how to allocate costs to departments. Without an accurate budget that correctly predicts costs and profits, meeting fiscal obligations and keeping your business compliant becomes a challenge. In this Webinar, Saturn Infotech’s technical and functional experts demonstrate how to streamline your planning and budgeting process with Oracle PBCS. You will learn how PBCS provides more comprehensive reporting options and simplifies company-wide hiring and budgeting, making headcount management a breeze!
SMB260: Service Manager: Portfolio and Project Management (PPM)Ivanti
Service Manager can be used for portfolio and project management (PPM) with the following key capabilities:
- It provides a single system to manage projects, track expenses, and link projects to other records like incidents or service requests.
- The PPM tools allow management to initiate, oversee, and analyze projects. Costing features track project budgets and spending.
- Customers can set up financial information, create portfolios and projects, plan projects with tasks and timelines, and track changes with dashboards and reports.
Seven Basic Steps to Build Realistic Schedule in Project 2010B Sai Prasad
The document outlines seven basic steps to build a realistic schedule in Project 2010: 1) enter project information, 2) create a work breakdown structure, 3) sequence tasks, 4) estimate resources, 5) optimize the schedule, 6) baseline the schedule, and 7) record progress. Each step provides dos and don'ts for using Project 2010 effectively. The goal is to create a schedule that is realistic, dynamic, and presentable.
Seven Basic Steps to Build Realistic Schedule in Project 2010B Sai Prasad
The document outlines seven basic steps to build a realistic schedule in Project 2010: 1) enter project information, 2) create a work breakdown structure, 3) sequence tasks, 4) estimate resources, 5) optimize the schedule, 6) baseline the schedule, and 7) record progress. Each step provides dos and don'ts for using Project 2010 effectively, such as setting the project start date in the project information section rather than the Gantt chart view. The goal is to create a schedule that is realistic, dynamic, and presentable.
The document describes a Primavera MS-Project add-on that provides earned value and earned schedule reporting for projects. The add-on allows uploading monthly progress data from all projects in an organization with one click. It then automatically generates indices, reports, dashboards and views to monitor project schedule and budget performance at different levels. The add-on provides more accurate and accessible earned value analysis than current methods.
This document provides an overview and outline for a 3-day, 8-hour per day basic Primavera training course. The course introduces participants to the Primavera interface and tools for project creation, work breakdown structures, activities, relationships, resources, and other functions. Each day focuses on a set of key topics, and includes exercises for participants to practice the skills learned.
The document provides an outline for a training presentation on project management using Primavera (P6). It discusses key concepts in project management including the differences between projects, operations, programs and portfolios. It also gives examples of project activities and resources. The document demonstrates how to plan a sample project in Primavera (P6), including defining the work breakdown structure, activity list, dependencies, and resource assignments. An overview of the Primavera software highlights the steps for project planning, scheduling, and monitoring.
Similar to Easily Create your Project WBS in MS-Excel with Simple Forward Scheduling using Project Partners UI-Apps (20)
