1
DESIGN AND PERFORMANCE
ANALYSIS OF BINARY ADDERS
A project report submitted towards partial
fulfillment of the requirements for the degree of Bachelor in Technology
in
Electronics and Telecommunication Engineering
By
RAHUL HANSDA (11010245)
SHITAL PRASAD BADAIK (11010240),
&
MADHU MANASI PATI (11011468),
of 7th
semester
Under the guidance of

Dr. Kabiraj Sethi

VEER SURENDRA SAI UNIVERSITY OF
TECHNOLOGY, BURLA, ODISHA
NOVEMBER-2014
2
VEER SURENDRA SAI UNIVERSITY OF TECHNOLOGY, BURLA
CERTIFICATE
This is to certify that the project entitled “DESIGN AND
PERFORMANCE ANALYSIS OF BINARY ADDERS” is carried out
by Rahul Hansda(11010245) ,Shital Prasad Badaik(11010240) , Madhu
Manasi Pati(11011468), and of the Department of Electronics and
Telecommunication Engineering, Veer Surendra Sai University of
Technology, Burla by a the virtue of the diligence and adherence to my
guidance and advice during the academic year 2014-2015.
Dr. D. Mishra Dr.Kabiraj Sethi

Head Of Department, Assistant Professor,
El. & Telecomm. Engg El. & Telecomm. Engg

VSSUT, Burla VSSUT, Burla

3

VEER SURENDRA SAI UNIVERSITY OF TECHNOLOGY, BURLA

CERTIFICATE OF APPROVAL*
This project entitled “DESIGN AND PERFORMANCE ANALYSIS OF
BINARY ADDERS” submitted by Rahul Hansda(11010245),Shital
Prasad Badaik(11010240), Madhu Manasi Pati(11011468), to Veer

Surendra Sai University of Technology, Burla has been examined by us.
It is found fit and approved for the degree of Bachelor of Technology.
INTERNAL EXAMINER EXTERNAL EXAMINER
*Only in casethe project is approved
4
ACKNOWLEDGEMENT
We feel honoured of this opportunity to express deep sense of gratitude
to our guide and acknowledge our indebtedness to Dr. Kabiraj Sethi,

Asst. Professor in Department of Electronics and Tele-communication
Engineering for assisting us to select the given project, giving valuable
guidance, encouragement and effort guiding us throughout our project.
We also thank our friends for their support and help they had rendered us
through the preparation of the project.
Rahul Hansda (11010245)

ETC, 7th Semester
Shital Prasad Badaik (11010240)

ETC, 7th Semester
Madhu Manasi Pati (11011468)
ETC, 7th Semester

5
ABSTRACT
Adders are one of the most widely implemented blocks of
microprocessor chips and digital components in the digital integrated
circuit design. They are the necessary part of Digital Signal Processing (DSP)
applications. With the advances in technology, researchers have tried and
are trying to design adders which offer either high speed, low power
consumption, less area or the combination of them.
Every adder generates a carry value that has to be propagated through
the circuit within a series of adders. This contributes largely to the critical
path delay of the circuit. By reducing the number of stages the carry has to
be propagated, the delay in the circuit can be reduced. The required sum is
selected using a multiplexer. This project deals with the design of various
adders such as Ripple Carry Adder (RCA), Carry Skip Adder (CSkA), Carry
Increment Adder (CIA), Carry Look Ahead Adder (CLAA), Carry Save
Adder (CSA), Carry Select Adder (CSlA), are discussed and the
performance parameters of adders such as area and delay are determined
and compared. Various adders are designed using Verilog HDL. Then, they
are simulated and synthesized using Xilinx ISE 8.2i for Spartan 3 family
device with speed grade -5.
6
CONTENTS
CHAPTER 1
1. Introduction
CHAPTER 2
2.0 Binary adders
2.0.1 Half adder
2.0.2 Full Adder
2.1 Types of adders
2.1.1 Ripple Carry Adder
2.1.2 Carry Look Ahead Adder
2.1.3 Carry Select Adder
2.1.4 Carry Save Adder
2.1.5 Carry Increment adder
2.1.6 Carry Skip Adder
CHAPTER 3 Designof Adders
3.1 Designof Ripple Carry Adder
3.1.1 Design of 4-bit Ripple Carry Adder
3.1.2 Design of 8-bit Ripple Carry Adder
3.1.3 Design of 16-bit Ripple Carry Adder
3.2 Designof Carry-Look Ahead Carry Adder
3.2.1 Design of 4-bit Carry-Look Ahead Carry Adder
3.2.2 Design of 8-bit-Carry-Look Ahead Carry Adder
3.2.3 Design of 16-bit-Carry-Look Ahead Carry Adder
3.3 Designof Carry SelectAdder
3.3.1 Design of 4-bit Carry Select Adder
3.3.2 Design of 8-bit Carry Select Adder
3.3.3 Design of 16-bit Carry Select Adder
3.4 Designof Carry Skip Adder
3.4.1 Design of 4-bit Carry Skip Adder
3.4.2 Design of 8-bit Carry Skip Adder
3.4.3 Design of 16-bit Carry Skip Adder
7
3.5 Designof Carry Increment Adder
3.5.1 Design of 4-bit Carry Increment Adder
3.5.2 Design of 8-bit Carry Increment Adder
3.5.3 Design of 16-bit Carry Increment Adder
3.6 Designof Carry Save Adder
3.6.1 Design of 4-bit Carry Save Adder
3.6.2 Design of 8-bit Carry Save Adder
3.6.3 Design of 16-bit Carry Save Adder
CHAPTER 4
Discussion and Results
CHAPTER 5
Conclusion
References
Bibliography
Appendix
8
LIST OF FIGURES
1. Figure 2.1 Half Adder logic diagram
2. Table 1.Truth Table for Half Adder
3. Figure2. 3 Full Adder circuit
4. Table 2.Truth Table for Full Adder circuit
5. Figure2. 3 Full Adder circuit
6. Figure 2.4 Truth Table for Full Adder cir
7. Fig. 2.5 Architecture of Ripple Carry Adder (RCA)
8. Figure 2.6 Carry Look Ahead Adder
9. Figure 2.7 Flowchart of Carry look Ahead Adder
10. Figure 2.8 Carry Select Adder
11. Fig. 2.9 Carry Save Adder (CSA)
12. Fig. 2.10 Carry Increment Adder
13. Fig 2.11 Carry Skip Adder
14. Table-3: Performance analysis of adders
9
Chapter1
1. INTRODUCTION
The objective of this project is to design different architectures of adders and to study
their respective performance, cost and design time. Adders are being used extensively in
many processor architectures and computational units. It is a vital part in any processor
or chip. By reducing the area occupied by these adders, the critical path delay can also be
reduced. This can be done by implementing different designs of these adders. The
ultimate aim of reducing the area and design is to optimize the cost of manufacture and
improve the efficiency of the processor.
Every adder generates a carry value that has to be propagated through the circuit within
a series of adders. This contributes largely to the critical path delay of the circuit. By
reducing the number of stages the carry has to be propagated, the delay in the circuit can
be reduced. This can be done by implementing different architectures of the adder
design and by incorporating varied logic to propagate the carry through the least
number of stages possible. One by looking ahead of several blocks, i.e., by identifying
where the actual output is and by delivering the carry signal right to that stage or by
calculating the sum before the propagation is started. The required sum is selected using
a multiplexer.
In the above cases, the carry signal is not propagated through more than three stages
which reduce the delay in the circuit. The various designs of adders are explained as
follows. In this project, we implement the following adders:
 Carry Ripple Adder
 Carry Skip Adder
 Carry Select Adder
 Carry Look Ahead adder
 Carry Save Adder
 Carry Increment Adder
The above designs are verified by performing the following steps
 RTL design using synthesis
 Logic simulation using Xilinx simulator
 Place and Route for power analysis
 Synthesis report for area and delay
10
Chapter 2

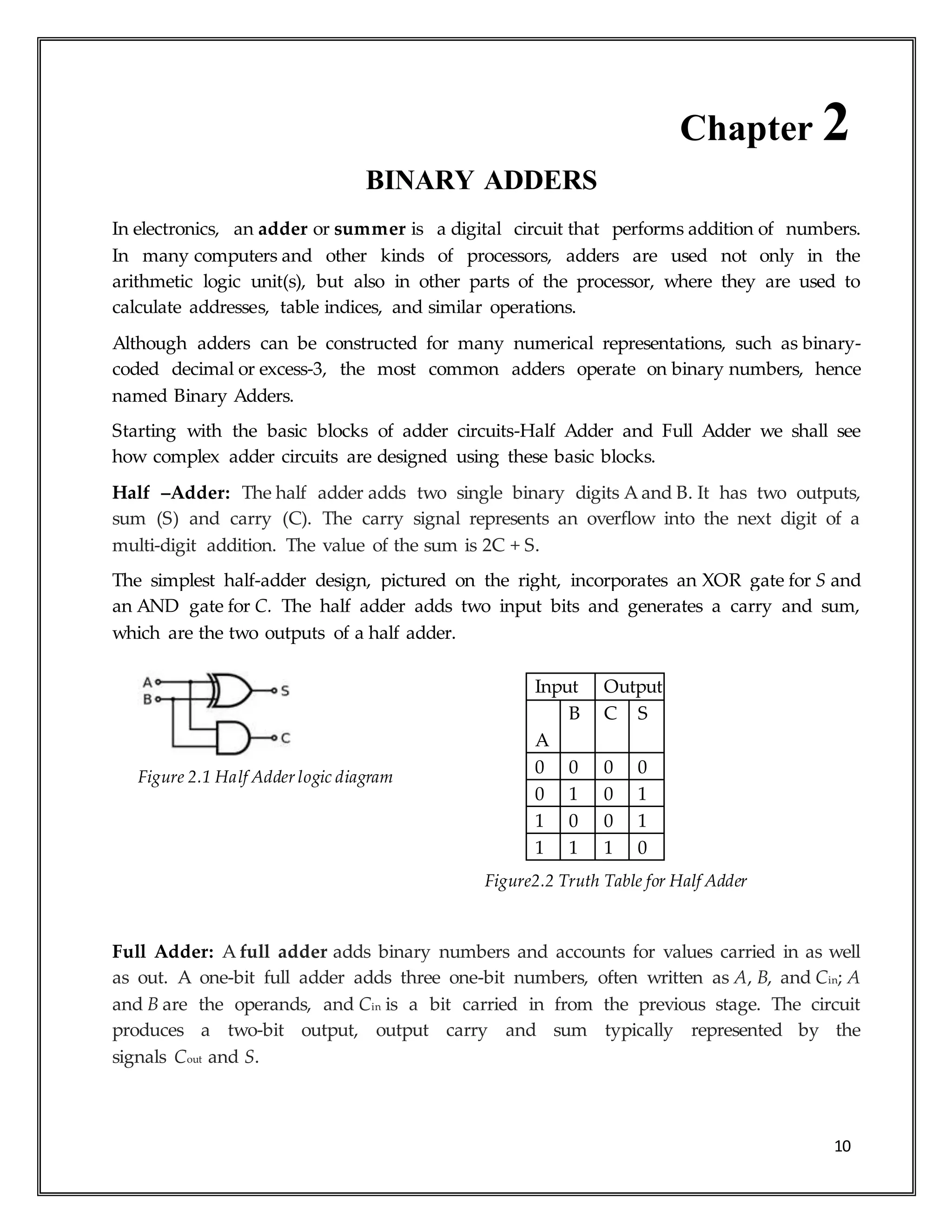

BINARY ADDERS
In electronics, an adder or summer is a digital circuit that performs addition of numbers.
In many computers and other kinds of processors, adders are used not only in the
arithmetic logic unit(s), but also in other parts of the processor, where they are used to
calculate addresses, table indices, and similar operations.
Although adders can be constructed for many numerical representations, such as binary-
coded decimal or excess-3, the most common adders operate on binary numbers, hence
named Binary Adders.
Starting with the basic blocks of adder circuits-Half Adder and Full Adder we shall see
how complex adder circuits are designed using these basic blocks.
Half –Adder: The half adder adds two single binary digits A and B. It has two outputs,
sum (S) and carry (C). The carry signal represents an overflow into the next digit of a
multi-digit addition. The value of the sum is 2C + S.
The simplest half-adder design, pictured on the right, incorporates an XOR gate for S and
an AND gate for C. The half adder adds two input bits and generates a carry and sum,
which are the two outputs of a half adder.
Figure 2.1 Half Adder logic diagram
Figure2.2 Truth Table for Half Adder
Full Adder: A full adder adds binary numbers and accounts for values carried in as well
as out. A one-bit full adder adds three one-bit numbers, often written as A, B, and Cin; A
and B are the operands, and Cin is a bit carried in from the previous stage. The circuit
produces a two-bit output, output carry and sum typically represented by the
signals Cout and S.
Input Output
A
B C S
0 0 0 0
0 1 0 1
1 0 0 1
1 1 1 0
11

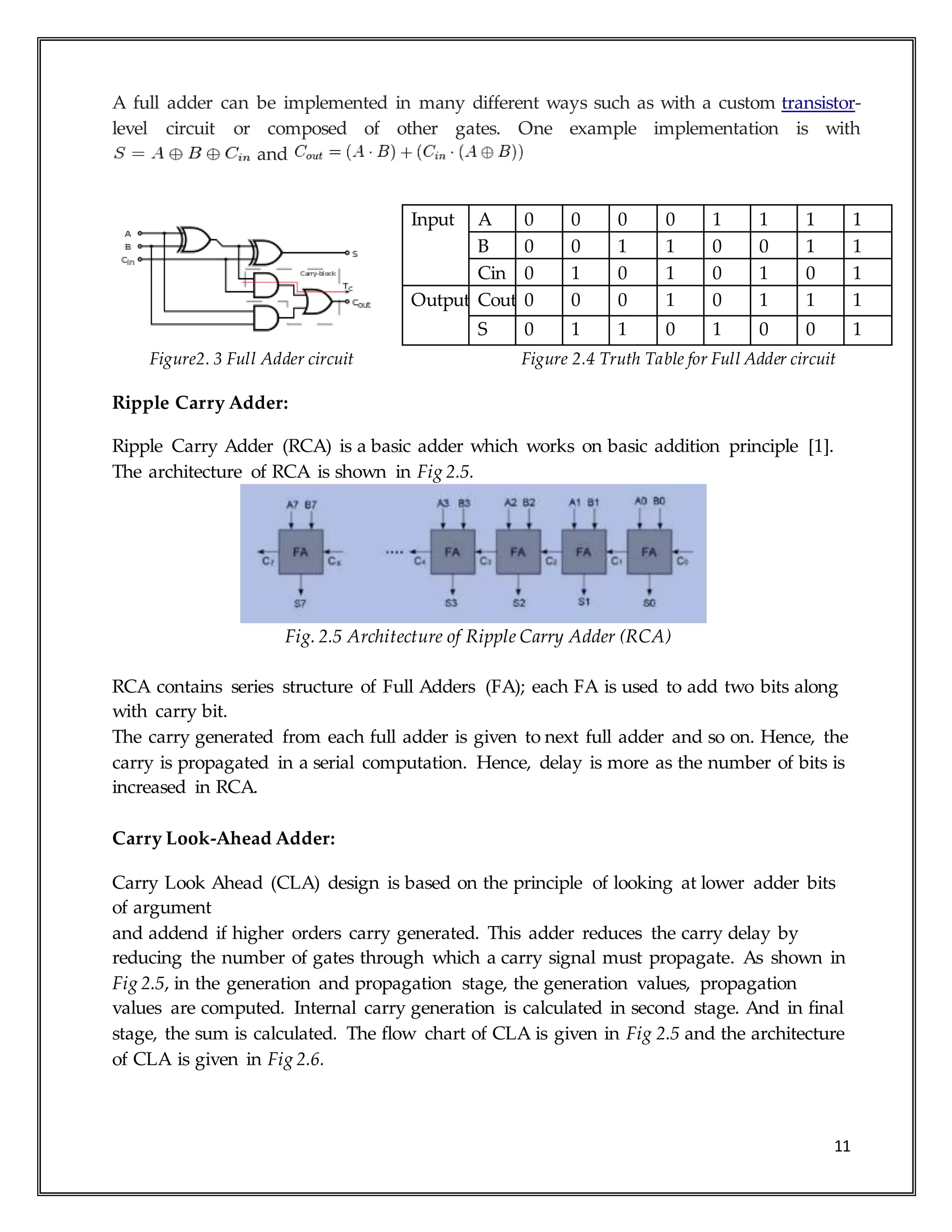

A full adder can be implemented in many different ways such as with a custom transistor-
level circuit or composed of other gates. One example implementation is with
and
Figure2. 3 Full Adder circuit Figure 2.4 Truth Table for Full Adder circuit
Ripple Carry Adder:
Ripple Carry Adder (RCA) is a basic adder which works on basic addition principle [1].
The architecture of RCA is shown in Fig 2.5.
Fig. 2.5 Architecture of Ripple Carry Adder (RCA)
RCA contains series structure of Full Adders (FA); each FA is used to add two bits along
with carry bit.
The carry generated from each full adder is given to next full adder and so on. Hence, the
carry is propagated in a serial computation. Hence, delay is more as the number of bits is
increased in RCA.
Carry Look-Ahead Adder:

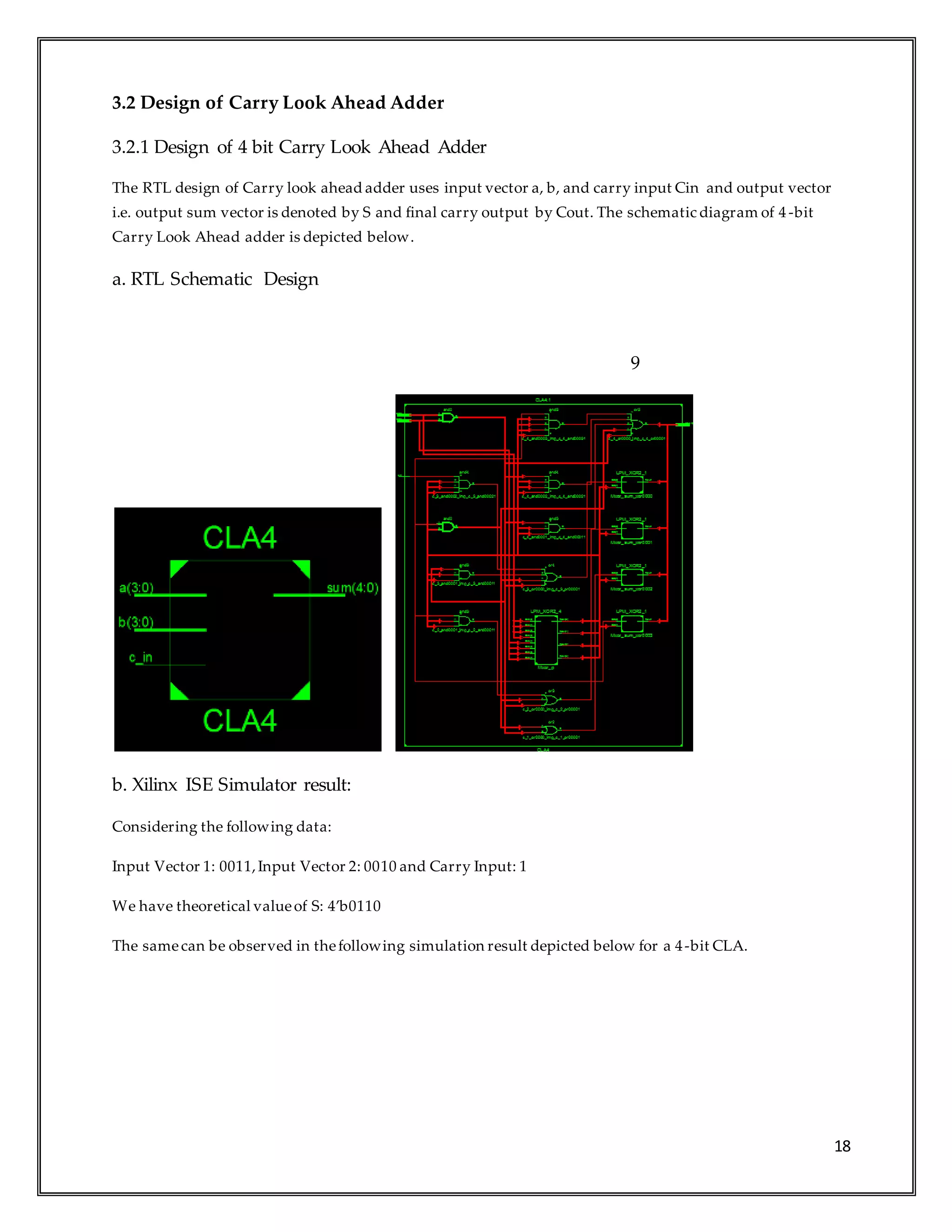

Carry Look Ahead (CLA) design is based on the principle of looking at lower adder bits
of argument
and addend if higher orders carry generated. This adder reduces the carry delay by
reducing the number of gates through which a carry signal must propagate. As shown in
Fig 2.5, in the generation and propagation stage, the generation values, propagation
values are computed. Internal carry generation is calculated in second stage. And in final
stage, the sum is calculated. The flow chart of CLA is given in Fig 2.5 and the architecture
of CLA is given in Fig 2.6.
Input A 0 0 0 0 1 1 1 1
B 0 0 1 1 0 0 1 1
Cin 0 1 0 1 0 1 0 1
Output Cout 0 0 0 1 0 1 1 1
S 0 1 1 0 1 0 0 1
12

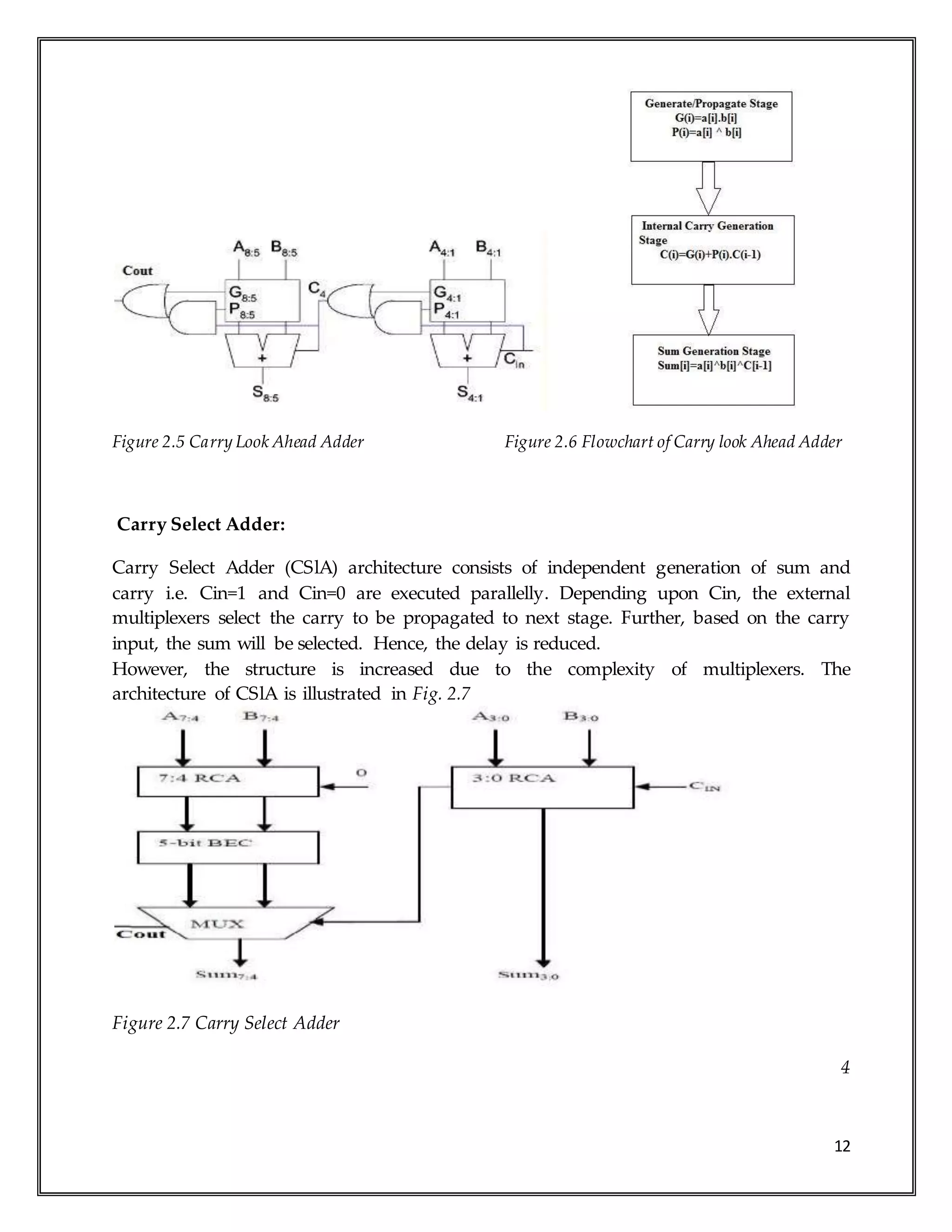

Figure 2.5 Carry Look Ahead Adder Figure 2.6 Flowchart of Carry look Ahead Adder

Carry Select Adder:

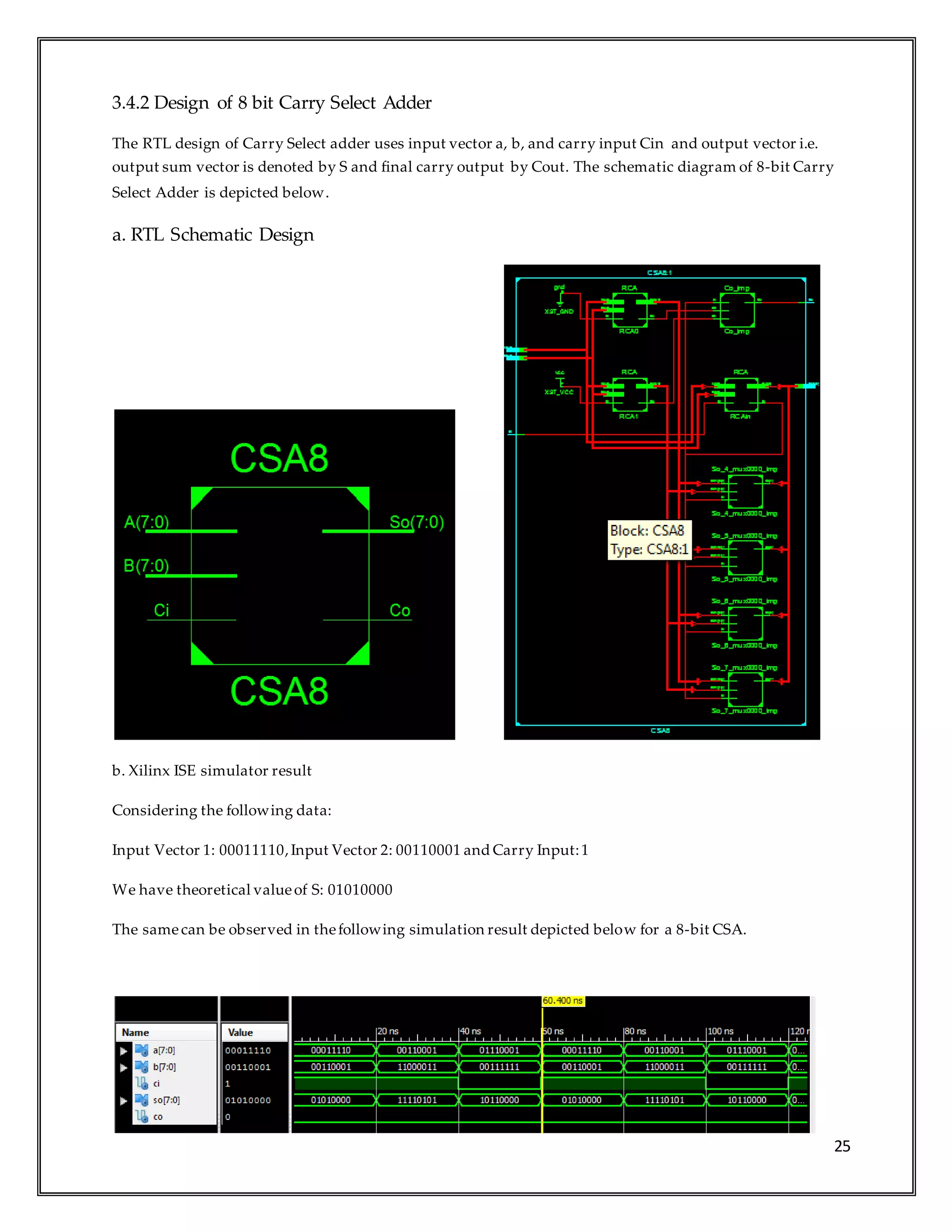

Carry Select Adder (CSlA) architecture consists of independent generation of sum and
carry i.e. Cin=1 and Cin=0 are executed parallelly. Depending upon Cin, the external
multiplexers select the carry to be propagated to next stage. Further, based on the carry
input, the sum will be selected. Hence, the delay is reduced.
However, the structure is increased due to the complexity of multiplexers. The

architecture of CSlA is illustrated in Fig. 2.7
Figure 2.7 Carry Select Adder
4

13

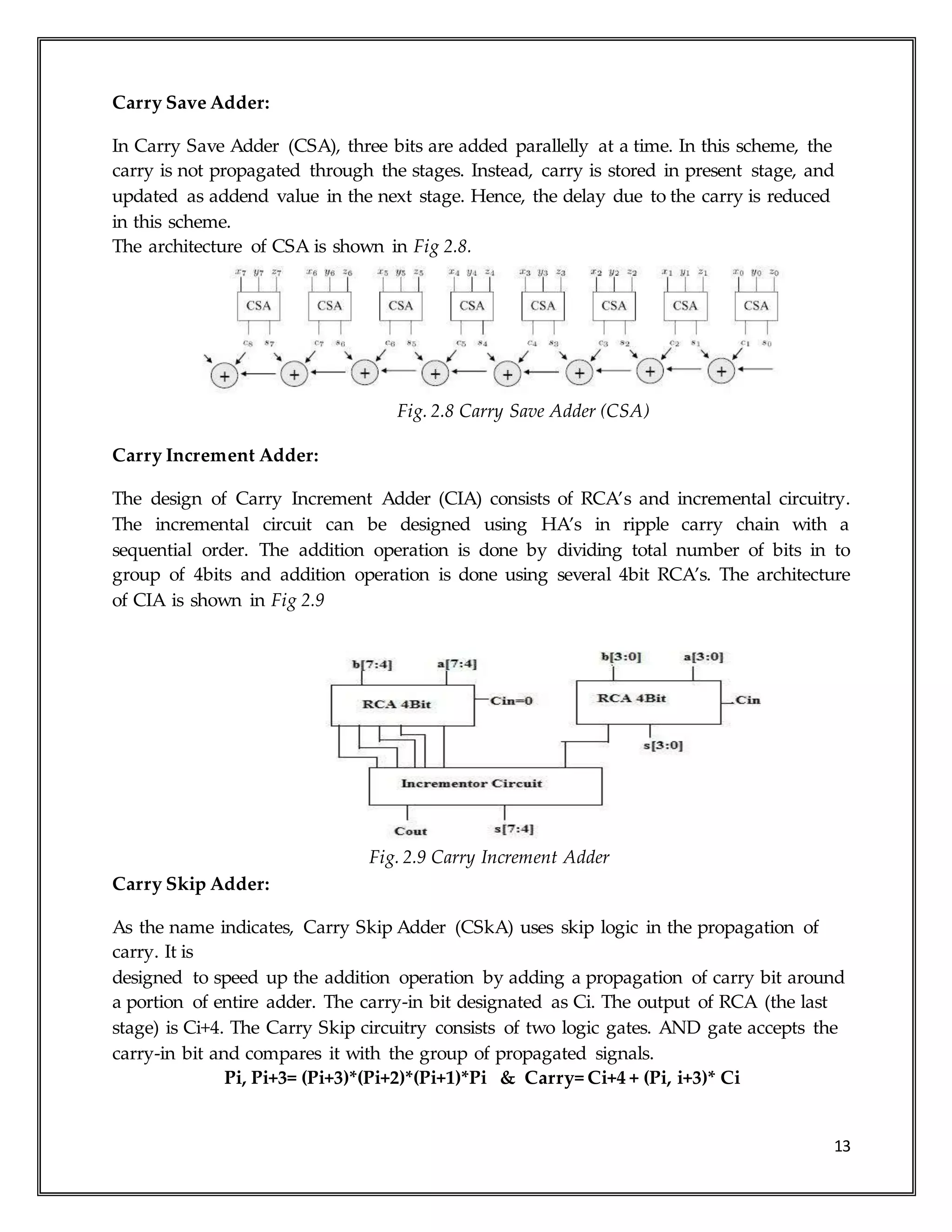

Carry Save Adder:

In Carry Save Adder (CSA), three bits are added parallelly at a time. In this scheme, the
carry is not propagated through the stages. Instead, carry is stored in present stage, and
updated as addend value in the next stage. Hence, the delay due to the carry is reduced
in this scheme.
The architecture of CSA is shown in Fig 2.8.
Fig. 2.8 Carry Save Adder (CSA)
Carry Increment Adder:

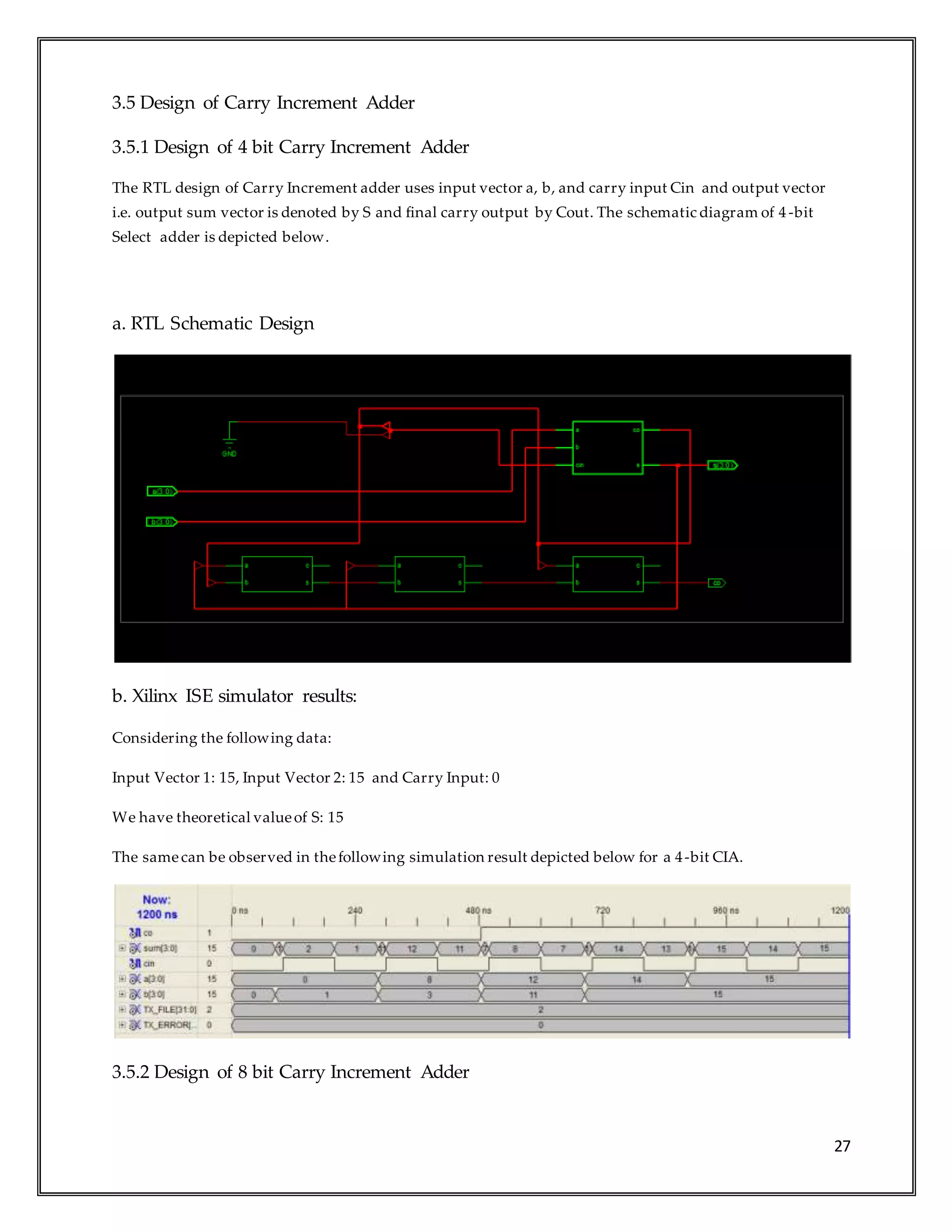

The design of Carry Increment Adder (CIA) consists of RCA’s and incremental circuitry.
The incremental circuit can be designed using HA’s in ripple carry chain with a
sequential order. The addition operation is done by dividing total number of bits in to
group of 4bits and addition operation is done using several 4bit RCA’s. The architecture
of CIA is shown in Fig 2.9
Fig. 2.9 Carry Increment Adder

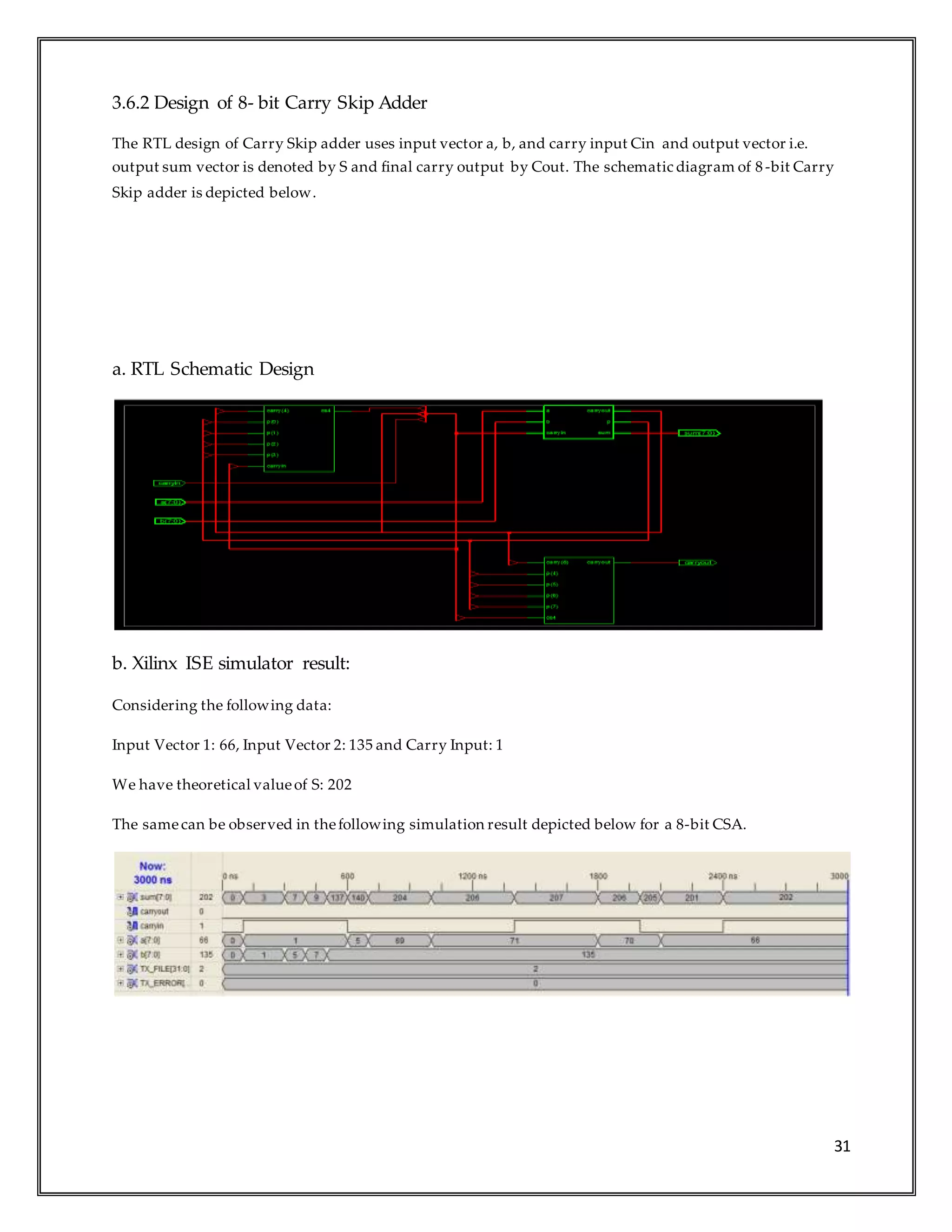

Carry Skip Adder:

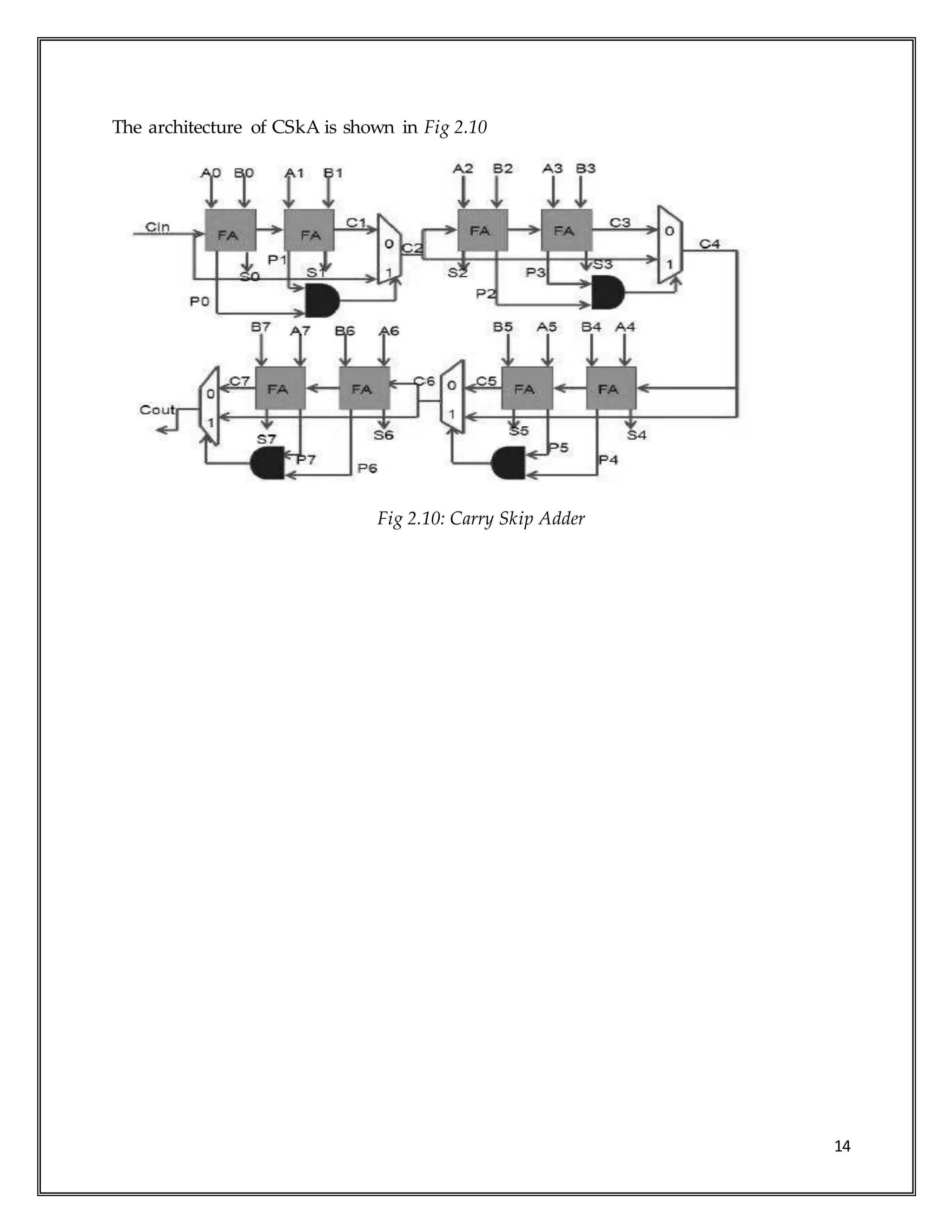

As the name indicates, Carry Skip Adder (CSkA) uses skip logic in the propagation of
carry. It is
designed to speed up the addition operation by adding a propagation of carry bit around
a portion of entire adder. The carry-in bit designated as Ci. The output of RCA (the last
stage) is Ci+4. The Carry Skip circuitry consists of two logic gates. AND gate accepts the
carry-in bit and compares it with the group of propagated signals.
Pi, Pi+3= (Pi+3)*(Pi+2)*(Pi+1)*Pi & Carry= Ci+4 + (Pi, i+3)* Ci
14
The architecture of CSkA is shown in Fig 2.10
Fig 2.10: Carry Skip Adder
15
Chapter 3
DESIGN OF BINARY ADDER
3.1 Design of Ripple Carry Adder
3.1.1 Design of 4 bit Ripple Carry Adder
The RTL design of Ripple Carry adder uses input vector a, b, and carry input Cin and
output vector i.e. output sum vector is denoted by S and final carry output by Cout. The
schematic diagram of 4-bit Ripple Carry Adder is depicted below.
a. RTL Schematic Design
b.Xilinx ISE simulator result
Considering the following data:
Input Vector 1: 9, Input Vector 2: 11 and Carry Input: 2
We have theoretical valueof S: 20
The samecan be observed in thefollowing simulation result depicted below for a 4-bit RCA.
16
3.1.2 Design of 8 bit Ripple Carry Adder
The RTL design of Ripple Carry adder uses input vector a, b, and carry input Cin and output vector i.e.
output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 8-bit Ripple
carry adder is depicted below.
a. RTL Schematic Design
b. Xilinx ISE Simulator result:
Considering the following data:
Input Vector 1: 29, Input Vector 2: 7 and Carry Input: 0
We have theoretical valueof S: 37
The samecan be observed in thefollowing simulation result depicted below for a 8-bit RCA.
17

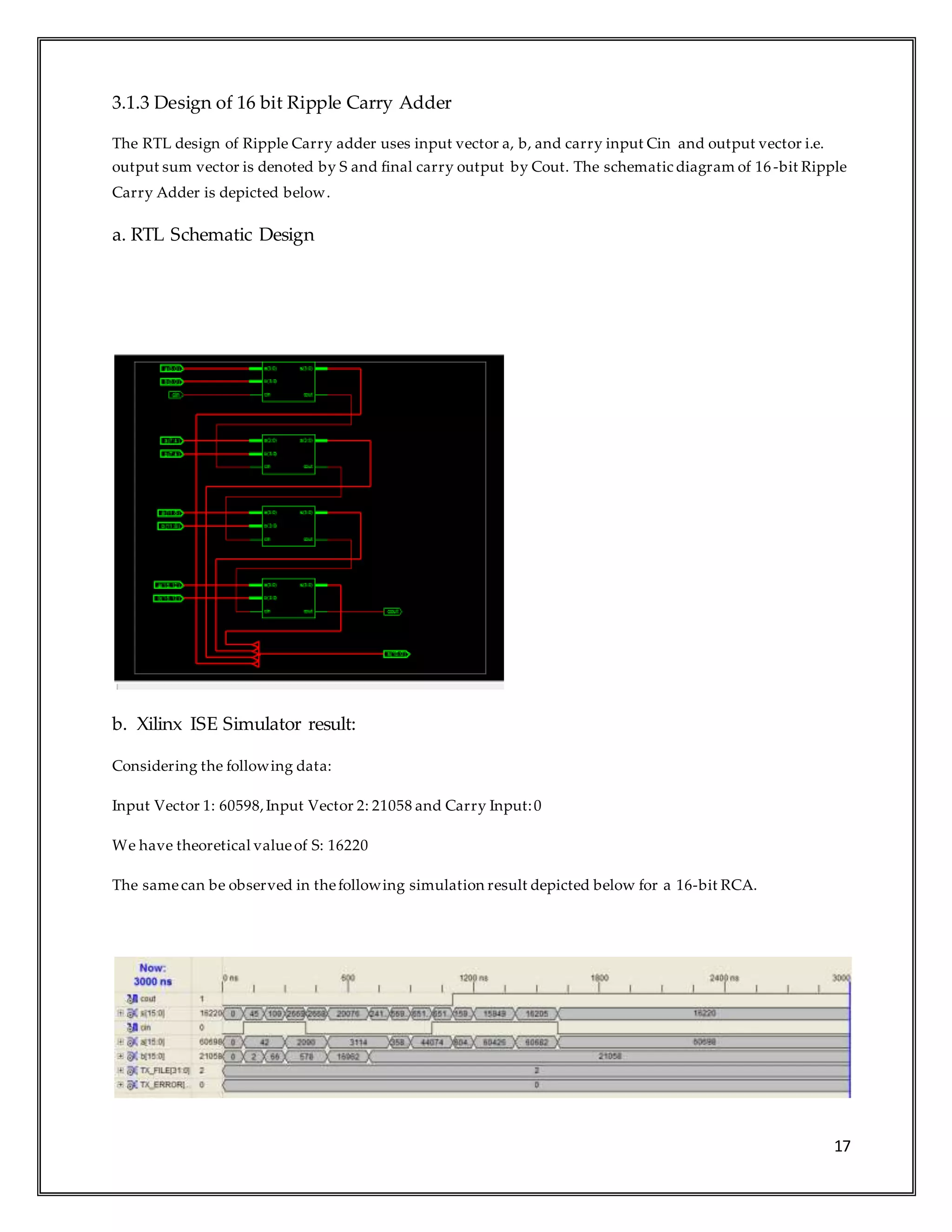

3.1.3 Design of 16 bit Ripple Carry Adder
The RTL design of Ripple Carry adder uses input vector a, b, and carry input Cin and output vector i.e.
output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 16 -bit Ripple
Carry Adder is depicted below.
a. RTL Schematic Design
b. Xilinx ISE Simulator result:
Considering the following data:
Input Vector 1: 60598,Input Vector 2: 21058 and Carry Input:0
We have theoretical valueof S: 16220
The samecan be observed in thefollowing simulation result depicted below for a 16-bit RCA.
18
3.2 Design of Carry Look Ahead Adder
3.2.1 Design of 4 bit Carry Look Ahead Adder
The RTL design of Carry look ahead adder uses input vector a, b, and carry input Cin and output vector
i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 4 -bit
Carry Look Ahead adder is depicted below.
a. RTL Schematic Design
9
b. Xilinx ISE Simulator result:
Considering the following data:
Input Vector 1: 0011,Input Vector 2: 0010 and Carry Input: 1
We have theoretical valueof S: 4’b0110
The samecan be observed in thefollowing simulation result depicted below for a 4-bit CLA.
19

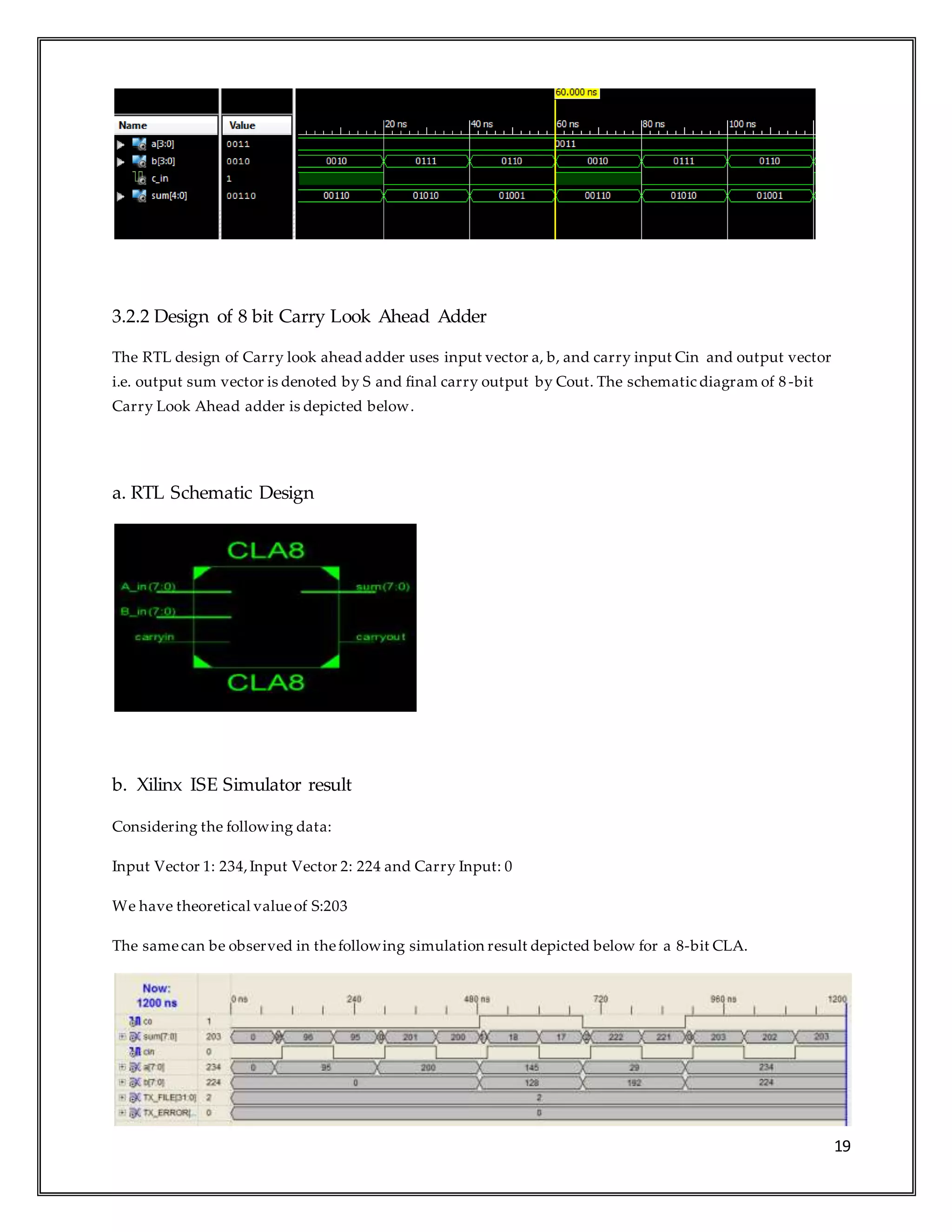

3.2.2 Design of 8 bit Carry Look Ahead Adder
The RTL design of Carry look ahead adder uses input vector a, b, and carry input Cin and output vector
i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 8 -bit
Carry Look Ahead adder is depicted below.
a. RTL Schematic Design
b. Xilinx ISE Simulator result
Considering the following data:
Input Vector 1: 234,Input Vector 2: 224 and Carry Input: 0
We have theoretical valueof S:203
The samecan be observed in thefollowing simulation result depicted below for a 8-bit CLA.
20

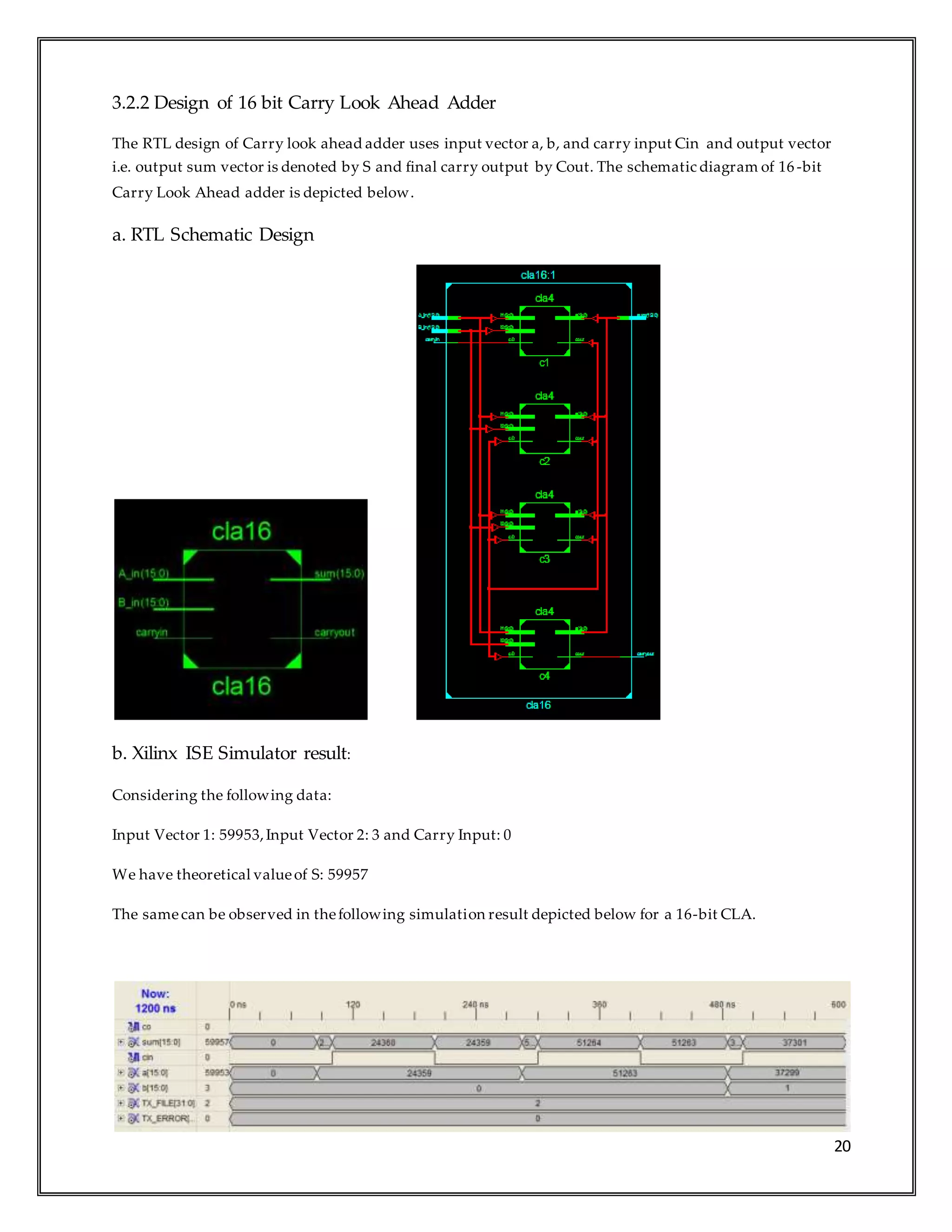

3.2.2 Design of 16 bit Carry Look Ahead Adder
The RTL design of Carry look ahead adder uses input vector a, b, and carry input Cin and output vector
i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 16 -bit
Carry Look Ahead adder is depicted below.
a. RTL Schematic Design
b. Xilinx ISE Simulator result:
Considering the following data:
Input Vector 1: 59953,Input Vector 2: 3 and Carry Input: 0
We have theoretical valueof S: 59957
The samecan be observed in thefollowing simulation result depicted below for a 16-bit CLA.
21

3.3 Design of Carry Select Adder
3.3.1 Design of 4 bit Carry Select Adder
The RTL design of Carry Select adder uses input vector a, b, and carry input Cin and output vector i.e.
output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 4-bit Carry
Select adder is depicted below.
a. RTL Schematic Design
b.Xilinx ISE Simulator result:
Considering the following data:
Input Vector 1: 14, Input Vector 2: 15 and Carry Input:0
We have theoretical valueof S:14
The samecan be observed in thefollowing simulation result depicted below for a 4-bit CSA.
22

3.3.2 Design of 8 bit Carry Select Adder
The RTL design of Carry Select adder uses input vector a, b, and carry input Cin and output vector i.e.
output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 4-bit Carry
Look Ahead adder is depicted below.
a. RTL Schematic Design
b. Xilinx ISE simulator result
Considering the following data:
Input Vector 1: 29, Input Vector 2: 7 and Carry Input: 0
We have theoretical valueof S: 37
The samecan be observed in thefollowing simulation result depicted below for a 8-bit CSA.
23

3.3.3 Design of 16 bit Carry Select Adder
The RTL design of Carry Select adder uses input vector a, b, and carry input Cin and output vector i.e.
output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 16 -bit Carry
Select adder is depicted below.
a. RTL Schematic Design
b. Xilinx ISE simulator result
Considering the following data:
Input Vector 1: 7609,Input Vector 2: 7 and Carry Input: 0
We have theoretical valueof S: 7617
The samecan be observed in thefollowing simulation result depicted below for a 16-bit CSA.
24

3.4 Design of Carry Save Adder

3.4.1 Design of 4 bit Carry Select Adder
The RTL design of Carry Select adder uses input vector a, b, and carry input Ci and output vector i.e.
output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 4-bit Carry
Select adder is depicted below.
a. RTL Schematic Design
b. Xilinx ISE simulator result
Considering the following data:
Input Vector 1: 0011,Input Vector 2: 0110 and Carry Input: 0
We have theoretical valueof S: 4’b1001
The samecan be observed in thefollowing simulation result depicted below for a 4-bit CSA.
25
3.4.2 Design of 8 bit Carry Select Adder
The RTL design of Carry Select adder uses input vector a, b, and carry input Cin and output vector i.e.
output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 8-bit Carry
Select Adder is depicted below.
a. RTL Schematic Design
b. Xilinx ISE simulator result
Considering the following data:
Input Vector 1: 00011110,Input Vector 2: 00110001 and Carry Input:1
We have theoretical valueof S: 01010000
The samecan be observed in thefollowing simulation result depicted below for a 8-bit CSA.
26

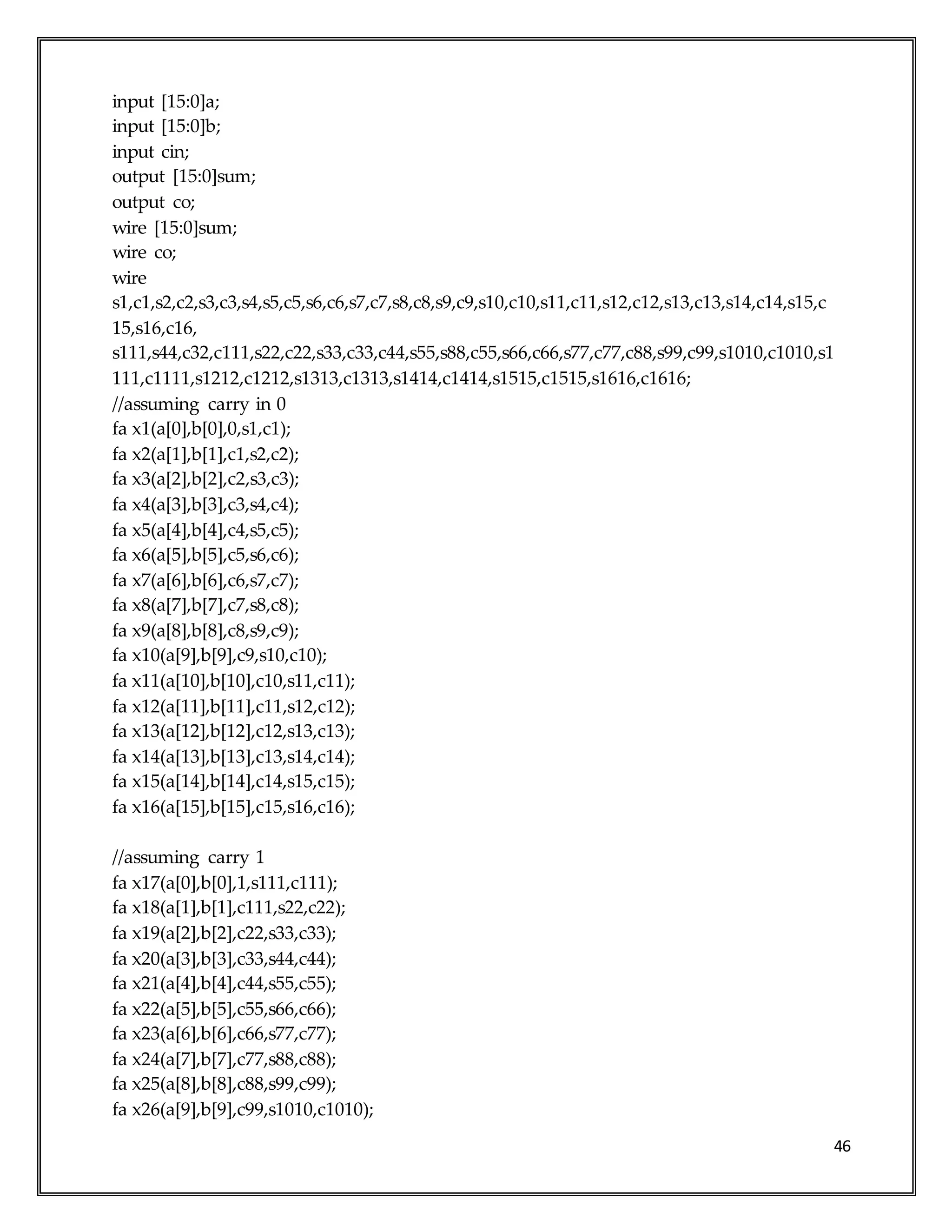

3.4.3 Design of 16 bit Carry Select Adder
The RTL design of Carry Select adder uses input vector a, b, and carry input Cin and output vector i.e.
output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 16-bit Carry
Select adder is depicted below.
a. RTL Schematic Design
b. Xilinx ISE simulator result:
Considering the following data:
Input Vector 1: 0011001000100010,Input Vector 2: 0000110011000001 and Carry Input:0
We have theoretical valueof S: 0011111011100011
The samecan be observed in thefollowing simulation result depicted below for a 16-bit CSA.
27
3.5 Design of Carry Increment Adder
3.5.1 Design of 4 bit Carry Increment Adder
The RTL design of Carry Increment adder uses input vector a, b, and carry input Cin and output vector
i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 4 -bit
Select adder is depicted below.
a. RTL Schematic Design
b. Xilinx ISE simulator results:
Considering the following data:
Input Vector 1: 15, Input Vector 2: 15 and Carry Input: 0
We have theoretical valueof S: 15
The samecan be observed in thefollowing simulation result depicted below for a 4-bit CIA.

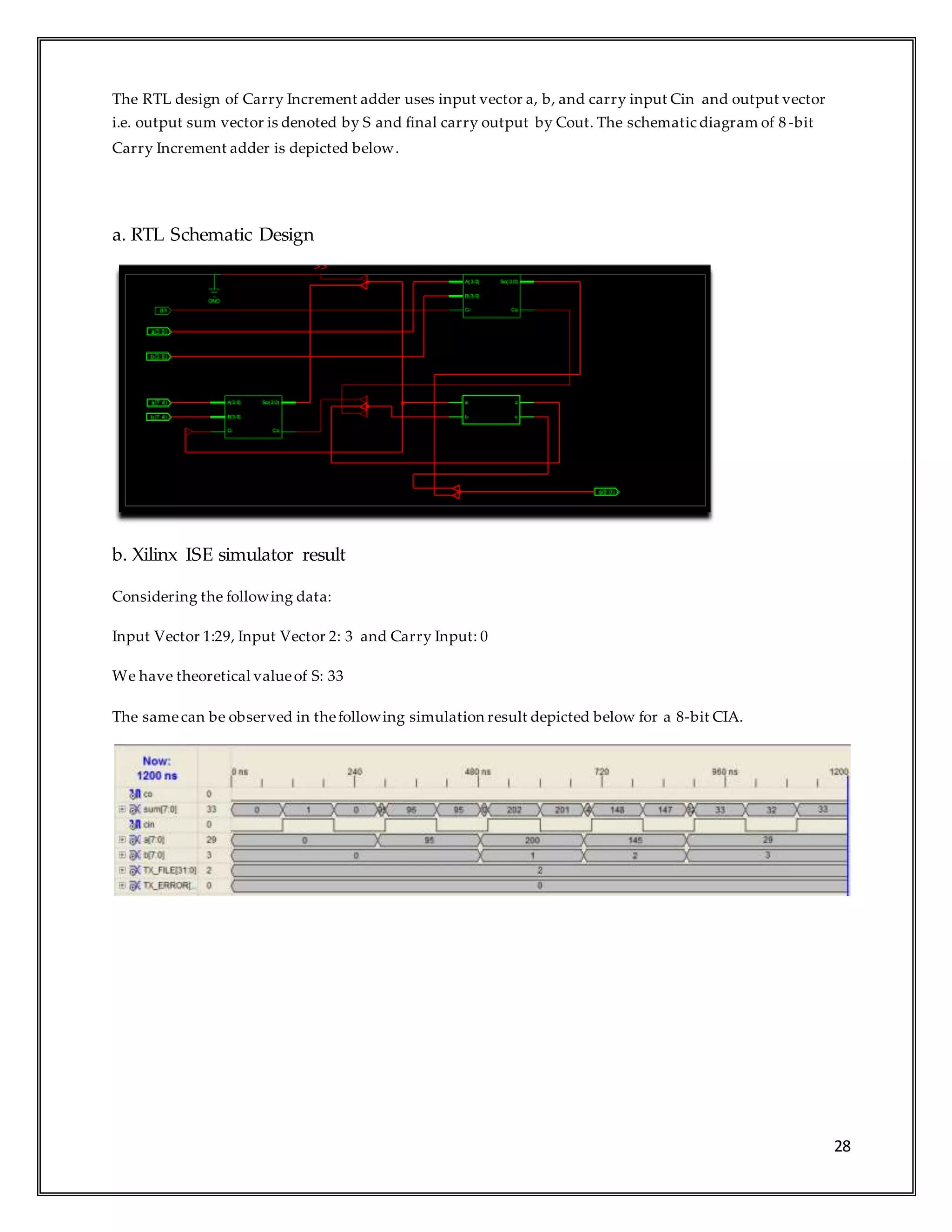

3.5.2 Design of 8 bit Carry Increment Adder
28
The RTL design of Carry Increment adder uses input vector a, b, and carry input Cin and output vector
i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 8 -bit
Carry Increment adder is depicted below.
a. RTL Schematic Design
b. Xilinx ISE simulator result
Considering the following data:
Input Vector 1:29, Input Vector 2: 3 and Carry Input: 0
We have theoretical valueof S: 33
The samecan be observed in thefollowing simulation result depicted below for a 8-bit CIA.
29
3.5.3 Design of 16- bit Carry Increment Adder
The RTL design of Carry Increment adder uses input vector a, b, and carry input Cin and output vector
i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 16-bit
Carry Increment adder is depicted below.
a. RTL Schematic Design
b. Xilinx ISE simulator result
Considering the following data:
Input Vector 1: 385,Input Vector 2: 3549 and Carry Input: 0
We have theoretical valueof S: 17’b 0042
The samecan be observed in thefollowing simulation result depicted below for a 16-bit CIA.
30

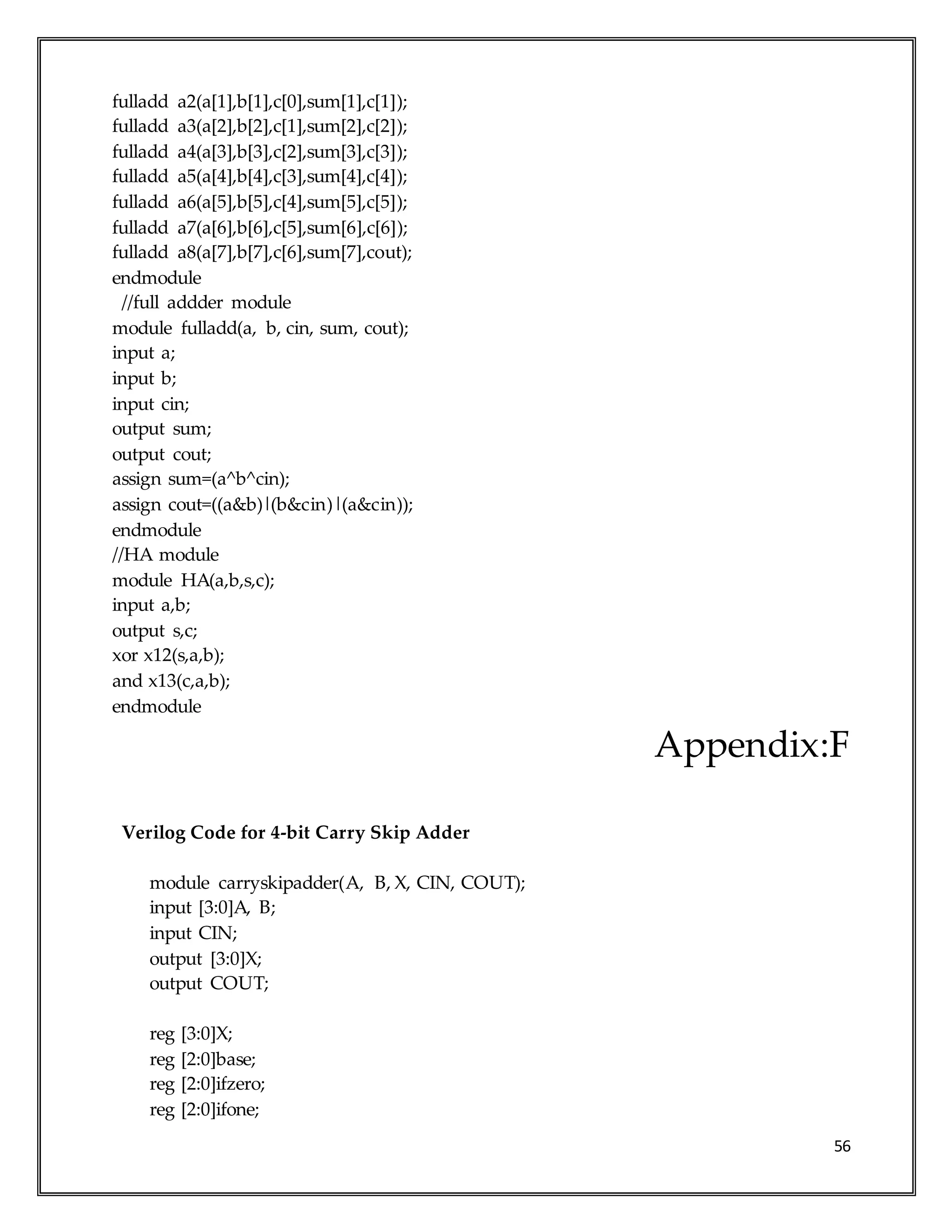

3.6 Design of Carry Skip Adder
3.6.1 Design of 4- bit Carry Skip Adder
The RTL design of Carry Skip adder uses input vector a, b, and carry input Cin and output vector i.e.
output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 4-bit Carry
Skip adder is depicted below.
a. RTL Schematic Design
b. Xilinx ISE simulator result
Considering the following data:
Input Vector 1: 5, Input Vector 2:7 and Carry Input: 0
We have theoretical valueof S: 13
The samecan be observed in thefollowing simulation result depicted below for a 4-bit CSA.

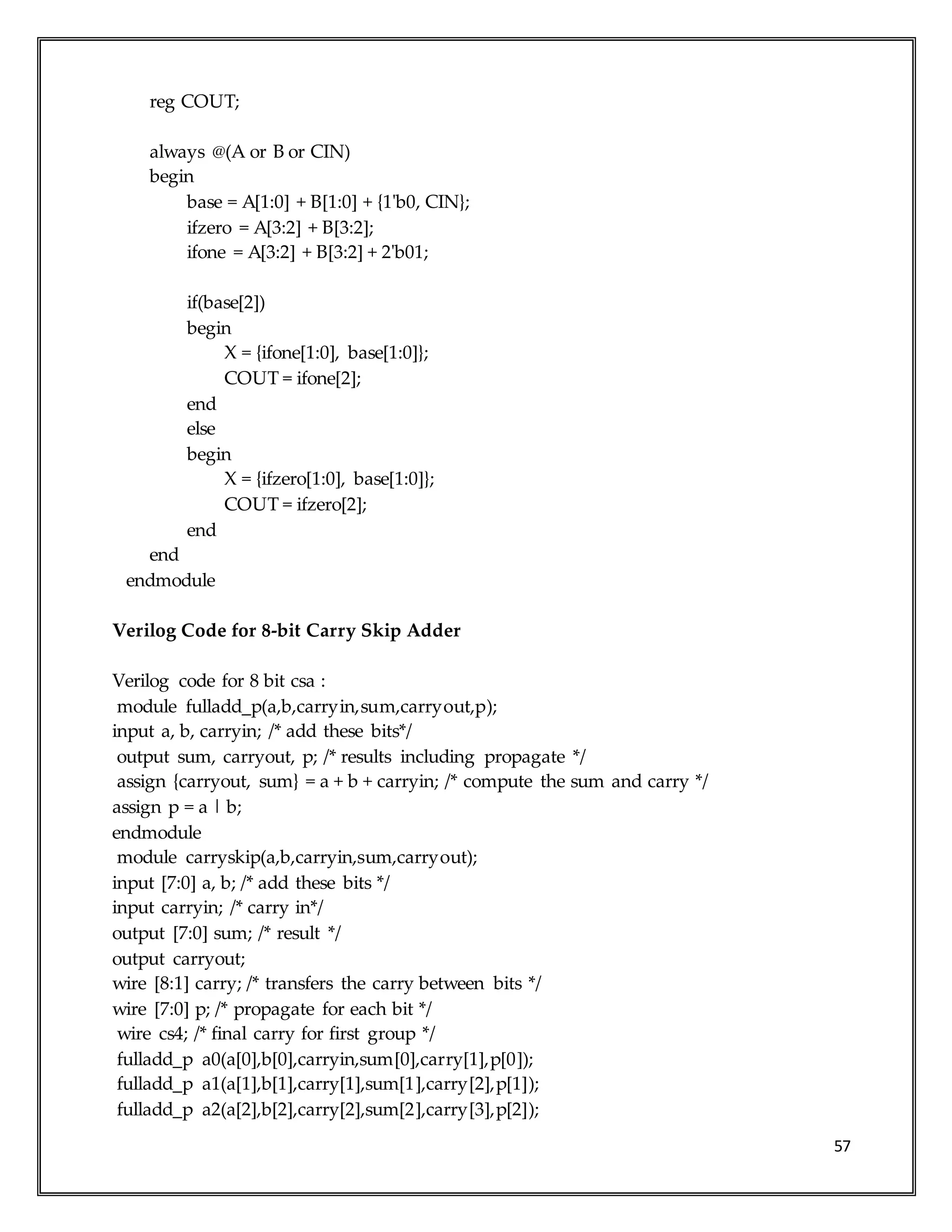

31
3.6.2 Design of 8- bit Carry Skip Adder
The RTL design of Carry Skip adder uses input vector a, b, and carry input Cin and output vector i.e.
output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 8-bit Carry
Skip adder is depicted below.
a. RTL Schematic Design
b. Xilinx ISE simulator result:
Considering the following data:
Input Vector 1: 66, Input Vector 2: 135 and Carry Input: 1
We have theoretical valueof S: 202
The samecan be observed in thefollowing simulation result depicted below for a 8-bit CSA.
32
3.6.2 Design of 16- bit Carry Skip Adder
The RTL design of Carry Skip adder uses input vector a, b, and carry input Cin and output vector i.e.
output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 4-bit Carry
Skip adder is depicted below.
a. RTL Schematic Design
b. Xilinx ISE simulator result:
Considering the following data:
Input Vector 1: 7609,Input Vector 2: 65532 and Carry Input: 0
We have theoretical valueof S: 7606
The samecan be observed in thefollowing simulation result depicted below for a 16-bit CSA.
33
Results and Discussion
There are six different complex adder circuit design which have been developed using
Verilog-HDL and synthesized in the ISE simulator tool using Xilinx ISE 8.2.Table I
exhibits post simulation results of the conventional adder circuits in terms of
Propagation delay (in ns), Area (in terms of No. of Slices and LUTs) and Power (in
mW).The Area Indicated the total cell area of the design; the total power is sum of
dynamic power, internal power, net power and leakage power. The delay is the critical
path delay of the adder circuits [2].
 The results shows that for a 4-bit adder circuit, the Carry Increment Adder circuit
has higher speed and minimum area when compared to other conventional adder
circuits depicted by the figure (2.9).
 The results shows that for a 8-bit adder circuit, the Carry Increment Adder circuit
has higher speed depicted by figure(2.9) and the Carry Look Ahead Adder has
minimum area when compared to other conventional adder circuits depicted by
the figure (2.5).
 The results shows that for a 16-bit adder circuit, the Carry Skip Adder circuit has
higher speed and minimum area when compared to other conventional adder
circuits depicted by the figure (2.10).
The marginal improvement in speed increases with the rise in word size of the adder.
This shows very well that the design can be incorporated into complex VLSI Design and
DSP applications in order to increase the operating speed of the circuits without
compromising in terms of area and path delay due to large carry chains.
34
T A B U L A T I O N
The Tabulation compares adder circuits for the area for different word sizes. It shows
that the area of ( ) adder circuit occupies minimum area when compared to other
conventional adder counterparts. The amount of area gain achieved in ( ) adder circuit
increases with word-size of the adders.
Table-3: Performance analysis of adders
4-bit 8-bit 16-bit
Types of Adders Area Pow
er(in
mW)
Dela
y(in
ns)
Area Powe
r(in
mW)
Del
ay
( in
ns)
Area Powe
r(in
mW)
Del
ay
(in
ns)
Ripple Carry Adder Slice-04
LUT-08
I/O-14
56.0
5
13.90
2
Slice-
08
LUT-15
I/O-26
56.05 18.6
46
Slice-
18
LUT-
32
I/O-50
56.05 33.3
78
Carry Look Ahead
Adder
Slice-04
LUT-08
I/O-14
56.0
5
11.89
7
Slice-
08
LUT-15
I/O-26
56.05 15.7
49
Slice-
19
LUT-
33
I/O-50
56.05 26.4
86
Carry Select Adder Slice-06
LUT-11
I/O-14
56.0
5
11.54
7
Slice-
13
LUT-24
I/O-26
56.05 14.9
03
Slice-
30
LUT-
56
I/O-50
56.05 19.9
34
Carry Save Adder Slice-03
LUT-06
I/O-14
56.0
5
9.142 Slice-
13
LUT-23
I/O-26
56.05 15.0
96
Slice-
31
LUT-
54
I/O-50
56.05 18.4
85
Carry Increment
Adder
Slice-03
LUT-06
I/O-14
56.0
5
9.043 Slice-
11
LUT-20
I/O-27
56.05 14.1
43
Slice-
24
LUT-
42
I/O-51
56.05 23.2
49
Carry Skip Adder Slice-04
LUT-08
I/O-14
56.0
5
13.52
1
Slice-
09
LUT-15
I/O-26
56.05 15.3
45
Slice-
14
LUT-
25
I/O-50
56.05 18.5
52
35
Conclusion:
The selected adder circuit with minimum area, power and delay is Carry Increment
Adder for 4-bit, in case of an 8-bit, there is a competence between Carry Look Ahead and
Carry Increment Adder and in case of a 16-bit, Carry Skip adder has minimum area and
delay which proves to be easy solution in improving the speed of the adder circuit over
other conventional adder circuits in discussion suffering from disadvantage of either
occupying more number of slices or look-up tables per unit of cell or have highest
minimum propagation delay owing to their critical carry path for same power (in
mW).The selected adder circuit is also found to have comparatively less power
consumption in comparison to other adder circuits. Hence it can be concluded on our
part that above respective adder circuit on the basis of different word size can be used to
speed up the final addition in parallel multiplier circuits and other architectures which
uses adder circuits no doubt, exhibiting maximum efficiency. The structure has been
synthesized using Xilinx ISE 8.2i and simulated using ISE simulator tool.
36
References:
1. A Very Fast and Low Power Carry Select Adder Circuit -Samiappa Sakthikumaran1,
S. Salivahanan, V. S. Kanchana Bhaaskaran2, V. Kavinilavu, B. Brindha and C. Vinoth,
Department of Electronics and Communication Engineering,SSN College of
Engineering, Kalavakkam, (Off)Chennai sakthikumaran87@gmail.com1,
vskanchana@hotmail.com2
2. International Journal of Science and Research (IJSR), Simulation of Different bit
Carry-Skip Adder in Verilog ,Sangeeta Rani1, Sachin Kumar2 1M. Tech Student,
Department of Electronics & Communication,2Faculty, Department of Electronics &
Communication, Meri College of Engineering & Technology, Sampla,Haryana, India
3. Efficient Implementation of Carry Save Adder, Sabyasachi Bhowmick , Mr. P. Mohan
Kumar Student – Department of Electronics & Communication Engineering ; LPU ;
Punjab, India Assistant Professor – Dept. of Electronics & Communication
Engineering ; LPU ; Punjab, India Sabyasachi0011@gmail.com Mohan.15771@lpu.co.in
4.International Journal of Computer Science and Mobile Computing, IJCSMC, Vol. 2,
Issue. 9, September 2013,RESEARCH ARTICLE, Design and Performance Analysis of
Various Adders using Verilog Maroju SaiKumar1, Dr. P. Samundiswary2 ¹Student,
Department of Electronics Engineering, Pondicherry University, Pondicherry,
India;²Assistant Professor, Department of Electronics Engineering, Pondicherry
University, Pondicherry, India
1 saikumar488@gmail.com; 2 samundiswary_pdy@yahoo.com
5 http://en.wikipedia.org/wiki/Adder_%28electronics%29
6. 1999 Computer Arithmetic –Algorithms and HardwareDesigns, Behrooz Parhami,Dept. of Electrical
and Computer Engineering, University of California, Santa Barbara
7. Digital Design 3rd Edition –M. Morris Mano
37

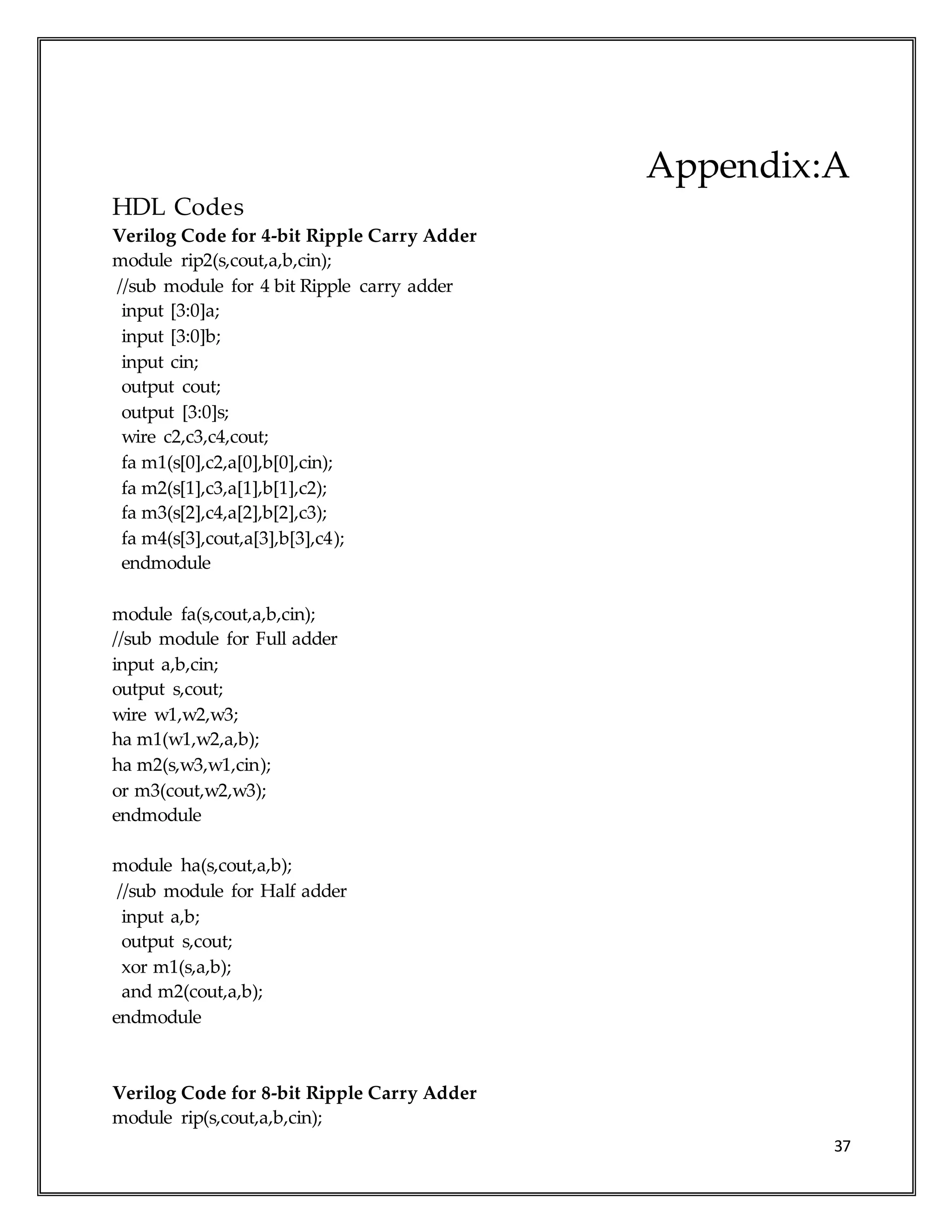

Appendix:A
HDL Codes
Verilog Code for 4-bit Ripple Carry Adder
module rip2(s,cout,a,b,cin);
//sub module for 4 bit Ripple carry adder
input [3:0]a;
input [3:0]b;
input cin;
output cout;
output [3:0]s;
wire c2,c3,c4,cout;
fa m1(s[0],c2,a[0],b[0],cin);
fa m2(s[1],c3,a[1],b[1],c2);
fa m3(s[2],c4,a[2],b[2],c3);
fa m4(s[3],cout,a[3],b[3],c4);
endmodule
module fa(s,cout,a,b,cin);
//sub module for Full adder
input a,b,cin;
output s,cout;
wire w1,w2,w3;
ha m1(w1,w2,a,b);
ha m2(s,w3,w1,cin);
or m3(cout,w2,w3);
endmodule
module ha(s,cout,a,b);
//sub module for Half adder
input a,b;
output s,cout;
xor m1(s,a,b);
and m2(cout,a,b);
endmodule
Verilog Code for 8-bit Ripple Carry Adder
module rip(s,cout,a,b,cin);
38
//main module of 8 bit Ripple carry adder
input [7:0]a;
input [7:0]b;
input cin;
output cout;
output [7:0]s;
wire c4,c8,cout;
rip2 m1(s[3:0],c4,a[3:0],b[3:0],cin);
rip2 m2(s[7:4],c8,a[7:4],b[7:4],cout);
endmodule
module rip2(s,cout,a,b,cin);
//sub module for 4 bit Ripple carry adder
input [3:0]a;
input [3:0]b;
input cin;
output cout;
output [3:0]s;
wire c2,c3,c4,cout;
fa m1(s[0],c2,a[0],b[0],cin);
fa m2(s[1],c3,a[1],b[1],c2);
fa m3(s[2],c4,a[2],b[2],c3);
fa m4(s[3],cout,a[3],b[3],c4);
endmodule
module fa(s,cout,a,b,cin);
//sub module for Full adder
input a,b,cin;
output s,cout;
wire w1,w2,w3;
ha m1(w1,w2,a,b);
ha m2(s,w3,w1,cin);
or m3(cout,w2,w3);
endmodule
module ha(s,cout,a,b);
//sub module for Half adder
input a,b;
output s,cout;
xor m1(s,a,b);
and m2(cout,a,b);
39
endmodule
Verilog Code for 16-bit Ripple Carry Adder
module rip(s,cout,a,b,cin);
//main module of 16 bit Ripple carry adder
input [15:0]a;
input [15:0]b;
input cin;
output cout;
output [15:0]s;
wire c4,c8,c12,cout;
rip2 m1(s[3:0],c4,a[3:0],b[3:0],cin);
rip2 m2(s[7:4],c8,a[7:4],b[7:4],c4);
rip2 m3(s[11:8],c12,a[11:8],b[11:8],c8);
rip2 m4(s[15:12],cout,a[15:12],b[15:12],c12);
endmodule
module rip2(s,cout,a,b,cin);
//sub module for 4 bit Ripple carry adder
input [3:0]a;
input [3:0]b;
input cin;
output cout;
output [3:0]s;
wire c2,c3,c4,cout;
fa m1(s[0],c2,a[0],b[0],cin);
fa m2(s[1],c3,a[1],b[1],c2);
fa m3(s[2],c4,a[2],b[2],c3);
fa m4(s[3],cout,a[3],b[3],c4);
endmodule
module fa(s,cout,a,b,cin);
//sub module for Full adder
input a,b,cin;
output s,cout;
wire w1,w2,w3;
ha m1(w1,w2,a,b);
ha m2(s,w3,w1,cin);
or m3(cout,w2,w3);
endmodule
40
module ha(s,cout,a,b);
//sub module for Half adder
input a,b;
output s,cout;
xor m1(s,a,b);
and m2(cout,a,b);
endmodule

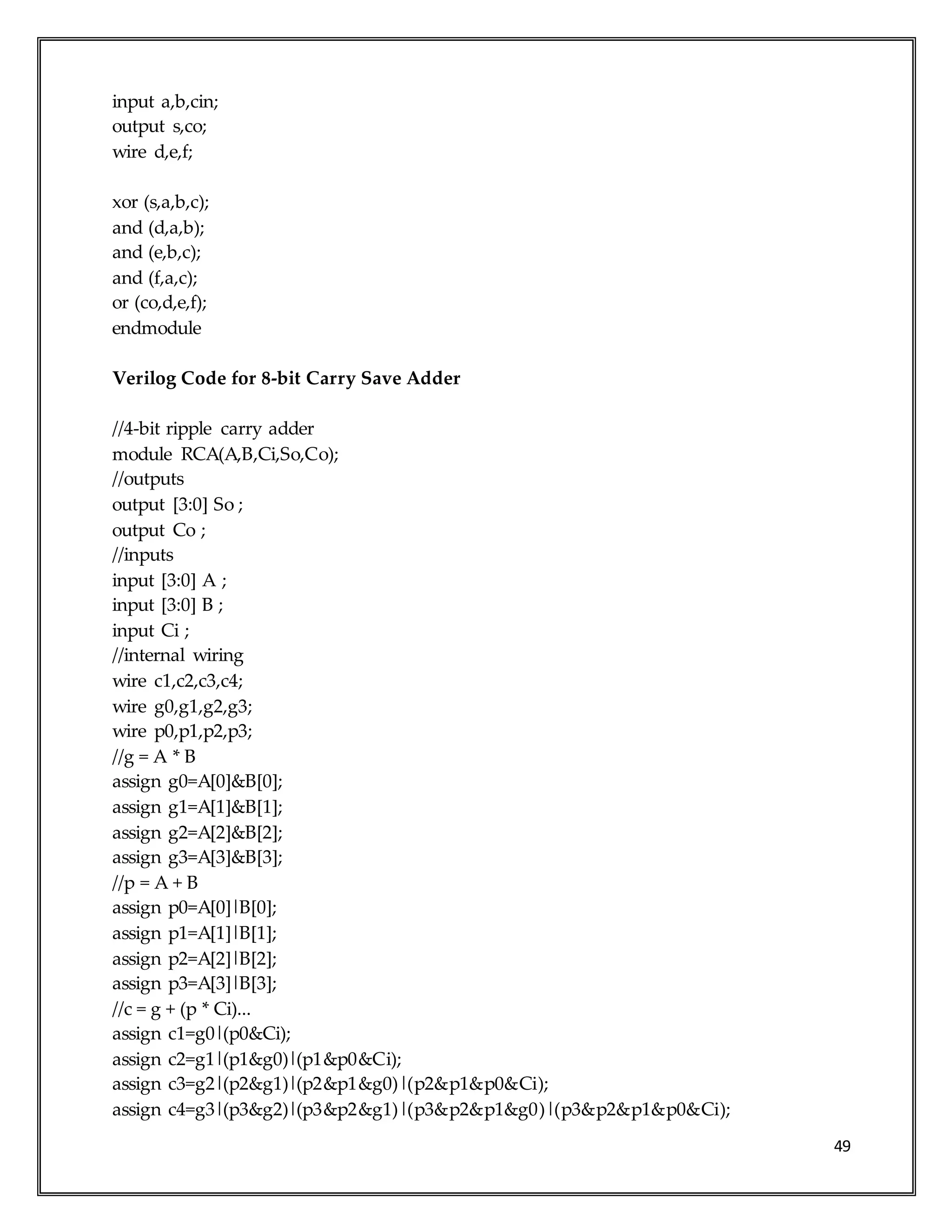

Appendix:B
Verilog code for 4 bit Carry Lookahead Adder

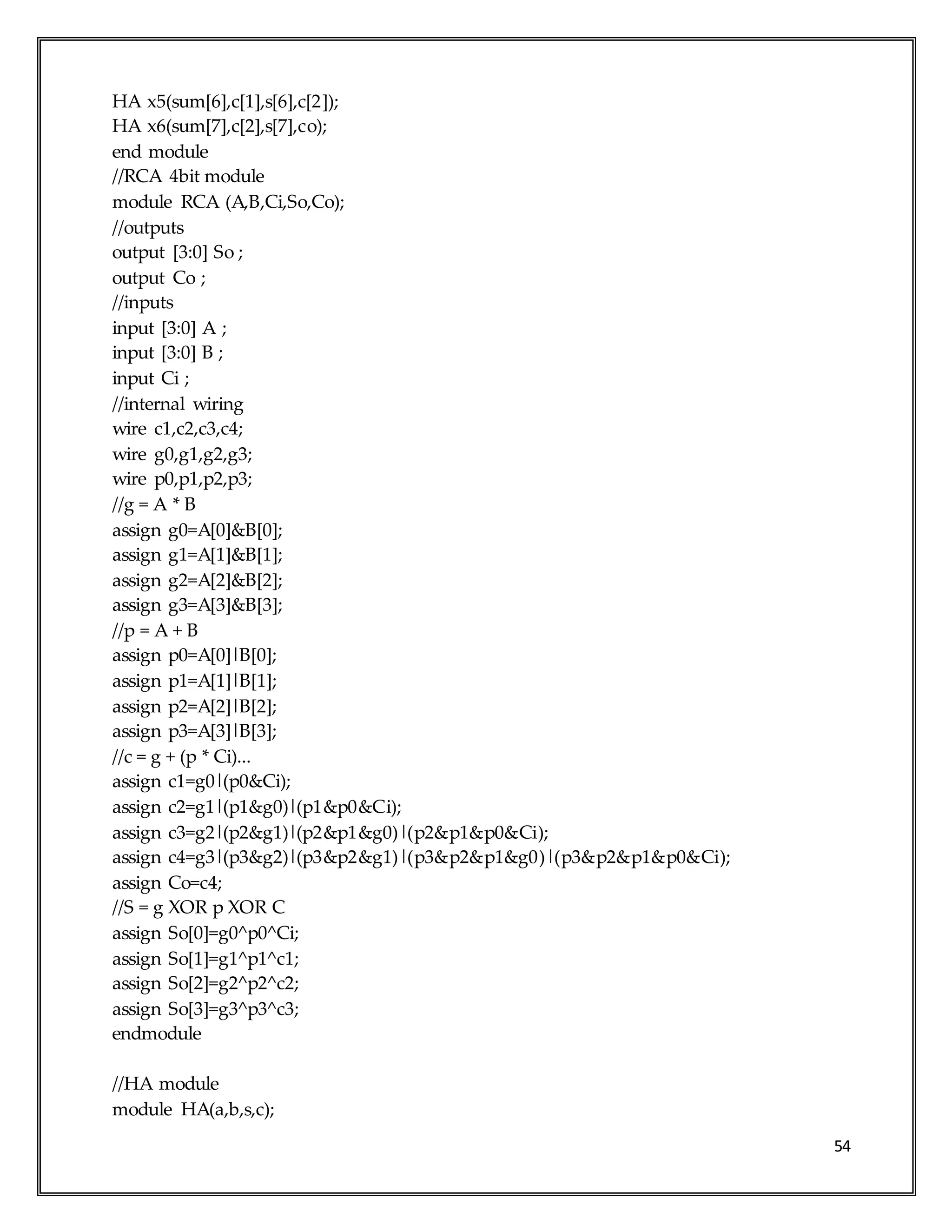

//4-bit ripple carry adder
module RCA(A,B,Ci,So,Co);
//outputs
output [3:0] So ;
output Co ;
//inputs
input [3:0] A ;
input [3:0] B ;
input Ci ;
//internal wiring
wire c1,c2,c3,c4;
wire g0,g1,g2,g3;
wire p0,p1,p2,p3;
//g = A * B
assign g0=A[0]&B[0];
assign g1=A[1]&B[1];
assign g2=A[2]&B[2];
assign g3=A[3]&B[3];
//p = A + B
assign p0=A[0]|B[0];
assign p1=A[1]|B[1];
assign p2=A[2]|B[2];
assign p3=A[3]|B[3];
//c = g + (p * Ci)...
assign c1=g0|(p0&Ci);
assign c2=g1|(p1&g0)|(p1&p0&Ci);
assign c3=g2|(p2&g1)|(p2&p1&g0)|(p2&p1&p0&Ci);
assign c4=g3|(p3&g2)|(p3&p2&g1)|(p3&p2&p1&g0)|(p3&p2&p1&p0&Ci);
assign Co=c4;
41
//S = g XOR p XOR C
assign So[0]=g0^p0^Ci;
assign So[1]=g1^p1^c1;
assign So[2]=g2^p2^c2;
assign So[3]=g3^p3^c3;
endmodule
Verilog Code for 8-bit Ripple Carrylookahead Adder
module CLA8(sum,carryout,A_in,B_in,carryin);
output [7:0] sum;
output carryout;
input [7:0] A_in;
input [7:0] B_in;
input carryin;
wire [7:0] sum;
wire carryout;
wire [2:0] carry;
cla4 c1(sum[3:0],carry[0],A_in[3:0],B_in[3:0],carryin);
cla4 c2(sum[7:4],carry[1],A_in[7:4],B_in[7:4],carry[0]);
//cla4 c3(sum[11:8],carry[2],A_in[11:8],B_in[11:8],carry[1]);
//cla4 c4(sum[15:12],carryout,A_in[15:12],B_in[15:12],carry[2]);
endmodule
//***************** 4-bit carry look-ahead adder **********************
module cla4(s,cout,i1,i2,c0);
output [3:0] s; //summation
output cout; //carryout
input [3:0] i1; //input1
input [3:0] i2; //input2
input c0;
wire [3:0] s;
wire cout;
wire [3:0] g;
wire [3:0] p;
wire [3:1] c;
assign g[3:0]=i1[3:0] & i2[3:0]; //carry generation
assign p[3:0]=i1[3:0] ^ i2[3:0]; //carry propagation
assign c[1]=g[0] | (p[0] & c0); //calculate each stage carryout
assign c[2]=g[1] | (g[0] & p[1]) | (p[0] & p[1] & c0);
assign c[3]=g[2] | (g[1] & p[2]) | (g[0] & p[1] & p[2]) | (p[0] & p[1] & p[2] &
42
c0);
assign cout=g[3] | (g[2] & p[3]) | (g[1] & p[2] & p[3])
| (g[0] & p[1] & p[2] & p[3]) | (p[0] & p[1] & p[2] & p[3] & c0);
assign s[0]=p[0]^c0; //calculate summation
assign s[3:1]=p[3:1]^c[3:1];
endmodule
Verilog Code for 16-bit Ripple Carrylookahead Adder
module cla16(sum,carryout,A_in,B_in,carryin);
output [15:0] sum;
output carryout;
input [15:0] A_in;
input [15:0] B_in;
input carryin;
wire [15:0] sum;
wire carryout;
wire [2:0] carry;
cla4 c1(sum[3:0],carry[0],A_in[3:0],B_in[3:0],carryin);
cla4 c2(sum[7:4],carry[1],A_in[7:4],B_in[7:4],carry[0]);
cla4 c3(sum[11:8],carry[2],A_in[11:8],B_in[11:8],carry[1]);
cla4 c4(sum[15:12],carryout,A_in[15:12],B_in[15:12],carry[2]);
endmodule
//***************** 4-bit carry look-ahead adder **********************
module cla4(s,cout,i1,i2,c0);
output [3:0] s; //summation
output cout; //carryout
input [3:0] i1; //input1
input [3:0] i2; //input2
input c0; //?????
wire [3:0] s;
wire cout;
wire [3:0] g;
wire [3:0] p;
wire [3:1] c;
assign g[3:0]=i1[3:0] & i2[3:0]; //carry generation
assign p[3:0]=i1[3:0] ^ i2[3:0]; //carry propagation
assign c[1]=g[0] | (p[0] & c0); //calculate each stage carryout
assign c[2]=g[1] | (g[0] & p[1]) | (p[0] & p[1] & c0);
assign c[3]=g[2] | (g[1] & p[2]) | (g[0] & p[1] & p[2]) | (p[0] & p[1] & p[2] &
43
c0);
assign cout=g[3] | (g[2] & p[3]) | (g[1] & p[2] & p[3])
| (g[0] & p[1] & p[2] & p[3]) | (p[0] & p[1] & p[2] & p[3] & c0);
assign s[0]=p[0]^c0; //calculate summation
assign s[3:1]=p[3:1]^c[3:1];
endmodule
Appendix:C
Verilog Code for 4-bit Carry Select Adder
module csa(a,b,cin,sum,co);
input [3:0]a;
input [3:0]b;
input cin;
output [3:0]sum;
output co;
wire [3:0]sum;
wire co;
wire s1,c1,s2,c2,s3,c3,s4,s11,s44,c4,c11,s22,c22,s33,c33,c44;
//assuming carry in 0
fa x1(a[0],b[0],0,s1,c1);
fa x2(a[1],b[1],c1,s2,c2);
fa x3(a[2],b[2],c2,s3,c3);
fa x4(a[3],b[3],c3,s4,c4);
//assuming carry in 1
fa x5(a[0],b[0],1,s11,c11);
fa x6(a[1],b[1],c11,s22,c22);
fa x7(a[2],b[2],c22,s33,c33);
fa x8(a[3],b[3],c33,s44,c44);
//select either carry 1 or 0 using carry out of FA
//mux for sum select
mux x9(s1,s11,cin,sum[0]);
mux x10(s2,s22,cin,sum[1]);
mux x11(s3,s33,cin,sum[2]);
mux x12(s4,s44,cin,sum[3]);
//mux for carry select
mux x13(c4,c44,cin,co);
endmodule
//fa module
44
module fa(a, b, c, sum, carry);
input a;
input b;
input c;
output sum;
output carry;
wire d,e,f;
xor(sum,a,b,c);
and(d,a,b);
and(e,b,c);
and(f,a,c);
or(carry,d,e,f);
endmodule
//mux module
module mux(a,b,s,q);
input a;
input b;
input s;
output q;
wire q;
assign q=s?b:a;
endmodule
Verilog Code for 8-bit Carry Select Adder

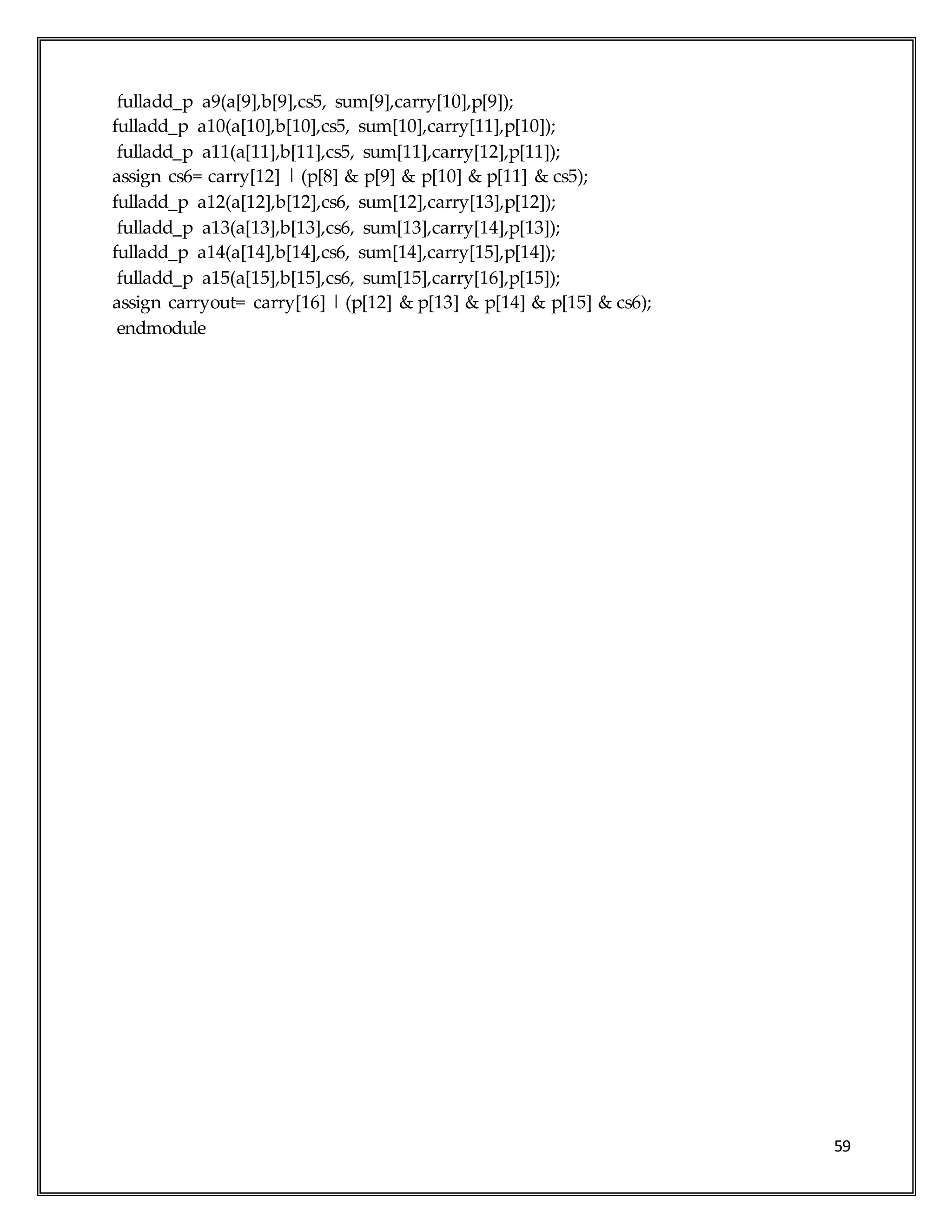

module CSA_8bit(a,b,cin,sum,co);
input [7:0]a;
input [7:0]b;
input cin;
output [7:0]sum;
output co;
wire [7:0]sum;
wire co;
wire s1,c1,s2,c2,s3,c3,s4,s11,s44,c4,c11,s22,c22,s33,c33,c44;
//assuming carry in 0
fa x1(a[1:0],b[1:0],0,s1,c1);
fa x2(a[3:2],b3:2],c1,s2,c2);
fa x3(a[5:4],b[5:4],c2,s3,c3);
fa x4(a[7:6],b[7:6],c3,s4,c4);
//assuming carry in 1
45
fa x5(a[1:0],b[1:0],1,s11,c11);
fa x6(a[3:2],b[3:2],c11,s22,c22);
fa x7(a[5:4],b[5:4],c22,s33,c33);
fa x8(a[7:6], b[7:6],c33,s44,c44);
//select either carry 1 or 0 using carry out of FA
//mux for sum select
mux x9(s1,s11,cin,sum[1:0]);
mux x10(s2,s22,cin,sum[3:2]);
mux x11(s3,s33,cin,sum[5:4]);
mux x12(s4,s44,cin,sum[7:6]);
//mux for carry select
mux x13(c4,c44,cin,co);
endmodule
//fa module
module fa(a, b, c, sum, carry);
input a;
input b;
input c;
output sum;
output carry;
wire d,e,f;
xor(sum,a,b,c);
and(d,a,b);
and(e,b,c);
and(f,a,c);
or(carry,d,e,f);
endmodule
//mux module
module mux(a,b,s,q);
input a;
input b;
input s;
output q;
wire q;
assign q=s?b:a;
endmodule
Verilog Code for 16-bit Carry Select Adder
module csa16bit(a,b,cin,sum,co);
46
input [15:0]a;
input [15:0]b;
input cin;
output [15:0]sum;
output co;
wire [15:0]sum;
wire co;
wire
s1,c1,s2,c2,s3,c3,s4,s5,c5,s6,c6,s7,c7,s8,c8,s9,c9,s10,c10,s11,c11,s12,c12,s13,c13,s14,c14,s15,c
15,s16,c16,
s111,s44,c32,c111,s22,c22,s33,c33,c44,s55,s88,c55,s66,c66,s77,c77,c88,s99,c99,s1010,c1010,s1
111,c1111,s1212,c1212,s1313,c1313,s1414,c1414,s1515,c1515,s1616,c1616;
//assuming carry in 0
fa x1(a[0],b[0],0,s1,c1);
fa x2(a[1],b[1],c1,s2,c2);
fa x3(a[2],b[2],c2,s3,c3);
fa x4(a[3],b[3],c3,s4,c4);
fa x5(a[4],b[4],c4,s5,c5);
fa x6(a[5],b[5],c5,s6,c6);
fa x7(a[6],b[6],c6,s7,c7);
fa x8(a[7],b[7],c7,s8,c8);
fa x9(a[8],b[8],c8,s9,c9);
fa x10(a[9],b[9],c9,s10,c10);
fa x11(a[10],b[10],c10,s11,c11);
fa x12(a[11],b[11],c11,s12,c12);
fa x13(a[12],b[12],c12,s13,c13);
fa x14(a[13],b[13],c13,s14,c14);
fa x15(a[14],b[14],c14,s15,c15);
fa x16(a[15],b[15],c15,s16,c16);
//assuming carry 1
fa x17(a[0],b[0],1,s111,c111);
fa x18(a[1],b[1],c111,s22,c22);
fa x19(a[2],b[2],c22,s33,c33);
fa x20(a[3],b[3],c33,s44,c44);
fa x21(a[4],b[4],c44,s55,c55);
fa x22(a[5],b[5],c55,s66,c66);
fa x23(a[6],b[6],c66,s77,c77);
fa x24(a[7],b[7],c77,s88,c88);
fa x25(a[8],b[8],c88,s99,c99);
fa x26(a[9],b[9],c99,s1010,c1010);
47
fa x27(a[10],b[10],c1010,s1111,c1111);
fa x28(a[11],b[11],c1111,s1212,c1212);
fa x29(a[12],b[12],c1212,s1313,c1313);
fa x30(a[13],b[13],c1313,s1414,c1414);
fa x31(a[14],b[14],c1414,s1515,c1515);
fa x32(a[15],b[15],c1515,s1616,c1616);
//select either carry 1 or 0 using carry out of FA
//mux for sum select
mux x33(s1,s111,cin,sum[0]);
mux x34(s2,s22,cin,sum[1]);
mux x35(s3,s33,cin,sum[2]);
mux x36(s4,s44,cin,sum[3]);
mux x37(s5,s55,cin,sum[4]);
mux x38(s6,s66,cin,sum[5]);
mux x39(s7,s77,cin,sum[6]);
mux x40(s8,s88,cin,sum[7]);
mux x41(s9,s99,cin,sum[8]);
mux x42(s10,s1010,cin,sum[9]);
mux x43(s11,s1111,cin,sum[10]);
mux x44(s12,s1212,cin,sum[11]);
mux x45(s13,s1313,cin,sum[12]);
mux x46(s14,s1414,cin,sum[13]);
mux x47(s15,s1515,cin,sum[14]);
mux x48(s16,s1616,cin,sum[15]);
//mux for carry select
mux x49(c16,c1616,cin,co);
endmodule
//fa module
module fa(a, b, c, sum, carry);
input a;
input b;
input c;
output sum;
output carry;
wire d,e,f;
xor(sum,a,b,c);
and(d,a,b);
and(e,b,c);
48
and(f,a,c);
or(carry,d,e,f);
endmodule
//mux module
module mux(a,b,s,q);
input a;
input b;
input s;
output q;
wire q;
assign q=s?b:a;
endmodule
Appendix:D
Verilog Code for 4-bit Carry Save Adder
module csa4(a,b,ci,s,co);
input [3:0]a;
input [3:0]b;
input ci;
output co;
output [3:0]s;
wire [5:0]c;
wire [3:0]stemp;
//overall circuit
FA x1(a[0],b[0],ci,s[0],c[0]);
FA x2(a[1],b[1],c[0],s[1],c[1]);
FA x3(a[2],b[2],1,stemp[0],c[2]);
FA x4(a[3],b[3],c[2],stemp[1],c[3]);
FA x5(a[2],b[2],1,stemp[2],c[4]);
FA x6(a[3],b[3],c[4],stemp[3],c5);
//conditional assignments
assign s[2]= c[1]?stemp[0]:stemp[1];
assign s[3]= c[1]?stemp[2]:stemp[3];
assign co=c[1]?c[3]:c[5];
endmodule
//FA module
module FA(a,b,cin,s,co);
49
input a,b,cin;
output s,co;
wire d,e,f;
xor (s,a,b,c);
and (d,a,b);
and (e,b,c);
and (f,a,c);
or (co,d,e,f);
endmodule
Verilog Code for 8-bit Carry Save Adder
//4-bit ripple carry adder
module RCA(A,B,Ci,So,Co);
//outputs
output [3:0] So ;
output Co ;
//inputs
input [3:0] A ;
input [3:0] B ;
input Ci ;
//internal wiring
wire c1,c2,c3,c4;
wire g0,g1,g2,g3;
wire p0,p1,p2,p3;
//g = A * B
assign g0=A[0]&B[0];
assign g1=A[1]&B[1];
assign g2=A[2]&B[2];
assign g3=A[3]&B[3];
//p = A + B
assign p0=A[0]|B[0];
assign p1=A[1]|B[1];
assign p2=A[2]|B[2];
assign p3=A[3]|B[3];
//c = g + (p * Ci)...
assign c1=g0|(p0&Ci);
assign c2=g1|(p1&g0)|(p1&p0&Ci);
assign c3=g2|(p2&g1)|(p2&p1&g0)|(p2&p1&p0&Ci);
assign c4=g3|(p3&g2)|(p3&p2&g1)|(p3&p2&p1&g0)|(p3&p2&p1&p0&Ci);
50
assign Co=c4;
//S = g XOR p XOR C
assign So[0]=g0^p0^Ci;
assign So[1]=g1^p1^c1;
assign So[2]=g2^p2^c2;
assign So[3]=g3^p3^c3;
endmodule
//8-bit carry save adder
module csa8(A,B,Ci,So,Co);
//outputs
output [7:0] So;
output Co;
//inputs
input [7:0] A,B;
input Ci;
//internal wiring
wire [3:0] stemp1,stemp0;
wire c4;
wire c80,c81;
//utilize RCA for CSA
RCA RCAin(A[3:0],B[3:0],Ci,So[3:0],c4);
RCA RCA1 (A[7:4],B[7:4],1'b1,stemp1,c81);
RCA RCA0 (A[7:4],B[7:4],1'b0,stemp0,c80);
//conditional assignments
assign So[7:4] = c4?stemp1:stemp0;
assign Co= c4?c81:c80;
endmodule
Verilog Code for 16-bit Carry Save Adder
module CSA16(A,B,Ci,So,Co);
input [15:0] A,B;
input Ci;
output [15:0] So;
output Co;
wire [7:0] stemp1,stemp0;
wire c8;
wire c160,c161;
CSA8 CSA8in(A[7:0],B[7:0],Ci,So[7:0],c8 );
CSA8 CSA81 (A[15:8],B[15:8],1'b1,stemp1,c161);
51
CSA8 CSA80 (A[15:8],B[15:8],1'b0,stemp0,c160);
assign So[15:8] = c8?stemp1:stemp0;
assign Co= c8?c161:c160;
endmodule
//4-bit ripple carry adder
module RCA (A,B,Ci,So,Co);
//outputs
output [3:0] So ;
output Co ;
//inputs
input [3:0] A ;
input [3:0] B ;
input Ci ;
//internal wiring
wire c1,c2,c3,c4;
wire g0,g1,g2,g3;
wire p0,p1,p2,p3;
//g = A * B
assign g0=A[0]&B[0];
assign g1=A[1]&B[1];
assign g2=A[2]&B[2];
assign g3=A[3]&B[3];
//p = A + B
assign p0=A[0]|B[0];
assign p1=A[1]|B[1];
assign p2=A[2]|B[2];
assign p3=A[3]|B[3];
//c = g + (p * Ci)...
assign c1=g0|(p0&Ci);
assign c2=g1|(p1&g0)|(p1&p0&Ci);
assign c3=g2|(p2&g1)|(p2&p1&g0)|(p2&p1&p0&Ci);
assign c4=g3|(p3&g2)|(p3&p2&g1)|(p3&p2&p1&g0)|(p3&p2&p1&p0&Ci);
assign Co=c4;
//S = g XOR p XOR C
assign So[0]=g0^p0^Ci;
assign So[1]=g1^p1^c1;
assign So[2]=g2^p2^c2;
assign So[3]=g3^p3^c3;
endmodule
52
//8-bit carry save adder
module CSA8(A,B,Ci,So,Co);
//outputs
output [7:0] So;
output Co;
//inputs
input [7:0] A,B;
input Ci;
//internal wiring
wire [3:0] stemp1,stemp0;
wire c4;
wire c80,c81;
//utilize RCA for CSA
RCA RCAin(A[3:0],B[3:0],Ci,So[3:0],c4);
RCA RCA1 (A[7:4],B[7:4],1'b1,stemp1,c81);
RCA RCA0 (A[7:4],B[7:4],1'b0,stemp0,c80);
//conditional assignments
assign So[7:4] = c4?stemp1:stemp0;
assign Co= c4?c81:c80;
endmodule
Appendix:E
Verilog Code for 4-bit Carry Increment Adder
module cia4bit(a,b,cin,s,co);
input [3:0]a;
input [3:0]b;
input cin;
output [3:0]s;
output co;
wire [2:0]sum;
wire c0,c1,c2,c3,c4,c5;
//overall ckircuit description
FA x1(a[0],b[0],0,s[0],c0);
FA x2(a[1],b[1],c0,s[1],c1);
FA x3(a[2],b[2],0,s[2],c2);
FA x4(a[3],b[3],c2,s[3],c3);
53
//incrementer circuit
HA x5(s[2],c1,sum[0],c4);
HA x6(s[3],c4,sum[1],c5);
HA x7(c3,c5,sum[2],co);
endmodule
//full adder module
module FA(a,b,cin,s,co);
input a,b,cin;
output s,co;
wire d,e,f;
xor (s,a,b,c);
and (d,a,b);
and (e,b,c);
and (f,a,c);
or (co,d,e,f);
endmodule
//half adder module
module HA(a,b,c,s);
input a,b;
output s,c;
xor(s,a,b);
and (c,a,b);
endmodule
Verilog Code for 8-bit Carry Increment Adder
module cia8(a,b,cin,s,co);
input [7:0]a;
input [7:0]b;
input cin;
output [7:0]s;
output co;
wire sum4,sum5,sum6,sum7,c[0],c[1],c[2];
//overall circuit desciption
RCA x1(a[3:0],b[3:0],cin,s[3:0],1);
RCA x2(a[7:4],b[7:4],0,sum[7:4],0);
//incrementor circuit
HA x3(sum[4],1,s[4],c[0]);
HA x4(sum[5],c[0],s[5],c[1]);
54
HA x5(sum[6],c[1],s[6],c[2]);
HA x6(sum[7],c[2],s[7],co);
end module
//RCA 4bit module
module RCA (A,B,Ci,So,Co);
//outputs
output [3:0] So ;
output Co ;
//inputs
input [3:0] A ;
input [3:0] B ;
input Ci ;
//internal wiring
wire c1,c2,c3,c4;
wire g0,g1,g2,g3;
wire p0,p1,p2,p3;
//g = A * B
assign g0=A[0]&B[0];
assign g1=A[1]&B[1];
assign g2=A[2]&B[2];
assign g3=A[3]&B[3];
//p = A + B
assign p0=A[0]|B[0];
assign p1=A[1]|B[1];
assign p2=A[2]|B[2];
assign p3=A[3]|B[3];
//c = g + (p * Ci)...
assign c1=g0|(p0&Ci);
assign c2=g1|(p1&g0)|(p1&p0&Ci);
assign c3=g2|(p2&g1)|(p2&p1&g0)|(p2&p1&p0&Ci);
assign c4=g3|(p3&g2)|(p3&p2&g1)|(p3&p2&p1&g0)|(p3&p2&p1&p0&Ci);
assign Co=c4;
//S = g XOR p XOR C
assign So[0]=g0^p0^Ci;
assign So[1]=g1^p1^c1;
assign So[2]=g2^p2^c2;
assign So[3]=g3^p3^c3;
endmodule
//HA module
module HA(a,b,s,c);
55
input a,b;
output s,c;
xor(s,a,b);
and(c,a,b);
end module
Verilog Code for 16-bit Carry Increment Adder
module cia16bit(a,b,cin,s,co);
input [15:0]a;
input [15:0]b;
input cin;
output [16:0]s;
output co;
wire [7:0]c;
wire [16:8]sum;
wire carry,carry1;
//overall circuit desciption
ripplemod x1(a[7:0],b[7:0],cin,s[7:0],carry);
ripplemod x2(a[15:8],b[15:8],0,sum[16:8],carry1);
//incrementor circuit
HA x3(sum[8],carry,s[8],c[0]);
HA x4(sum[9],c[0],s[9],c[1]);
HA x5(sum[10],c[1],s[10],c[2]);
HA x6(sum[11],c[2],s[11],c[3]);
HA x7(sum[12],c[3],s[12],c[4]);
HA x8(sum[13],c[4],s[13],c[5]);
HA x9(sum[14],c[5],s[14],c[6]);
HA x10(sum[15],c[6],s[15],c[7]);
HA x11(sum[16],carry1,s[16],co);
endmodule
//RCA 8bit module
module ripplemod(a, b, cin, sum, cout);
input [07:0] a;
input [07:0] b;
input cin;
output [7:0]sum;
output cout;
wire[6:0] c;
fulladd a1(a[0],b[0],cin,sum[0],c[0]);
56
fulladd a2(a[1],b[1],c[0],sum[1],c[1]);
fulladd a3(a[2],b[2],c[1],sum[2],c[2]);
fulladd a4(a[3],b[3],c[2],sum[3],c[3]);
fulladd a5(a[4],b[4],c[3],sum[4],c[4]);
fulladd a6(a[5],b[5],c[4],sum[5],c[5]);
fulladd a7(a[6],b[6],c[5],sum[6],c[6]);
fulladd a8(a[7],b[7],c[6],sum[7],cout);
endmodule
//full addder module
module fulladd(a, b, cin, sum, cout);
input a;
input b;
input cin;
output sum;
output cout;
assign sum=(a^b^cin);
assign cout=((a&b)|(b&cin)|(a&cin));
endmodule
//HA module
module HA(a,b,s,c);
input a,b;
output s,c;
xor x12(s,a,b);
and x13(c,a,b);
endmodule
Appendix:F
Verilog Code for 4-bit Carry Skip Adder
module carryskipadder(A, B, X, CIN, COUT);
input [3:0]A, B;
input CIN;
output [3:0]X;
output COUT;
reg [3:0]X;
reg [2:0]base;
reg [2:0]ifzero;
reg [2:0]ifone;
57
reg COUT;
always @(A or B or CIN)
begin
base = A[1:0] + B[1:0] + {1'b0, CIN};
ifzero = A[3:2] + B[3:2];
ifone = A[3:2] + B[3:2] + 2'b01;
if(base[2])
begin
X = {ifone[1:0], base[1:0]};
COUT = ifone[2];
end
else
begin
X = {ifzero[1:0], base[1:0]};
COUT = ifzero[2];
end
end
endmodule
Verilog Code for 8-bit Carry Skip Adder
Verilog code for 8 bit csa :
module fulladd_p(a,b,carryin,sum,carryout,p);
input a, b, carryin; /* add these bits*/
output sum, carryout, p; /* results including propagate */
assign {carryout, sum} = a + b + carryin; /* compute the sum and carry */
assign p = a | b;
endmodule
module carryskip(a,b,carryin,sum,carryout);
input [7:0] a, b; /* add these bits */
input carryin; /* carry in*/
output [7:0] sum; /* result */
output carryout;
wire [8:1] carry; /* transfers the carry between bits */
wire [7:0] p; /* propagate for each bit */
wire cs4; /* final carry for first group */
fulladd_p a0(a[0],b[0],carryin,sum[0],carry[1],p[0]);
fulladd_p a1(a[1],b[1],carry[1],sum[1],carry[2],p[1]);
fulladd_p a2(a[2],b[2],carry[2],sum[2],carry[3],p[2]);
58
fulladd_p a3(a[3],b[3],carry[3],sum[3],carry[4],p[3]);
assign cs4 = carry[4] | (p[0] & p[1] & p[2] & p[3] & carryin);
fulladd_p a4(a[4],b[4],cs4, sum[4],carry[5],p[4]);
fulladd_p a5(a[5],b[5],cs4, sum[5],carry[6],p[5]);
fulladd_p a6(a[6],b[6],cs4, sum[6],carry[7],p[6]);
fulladd_p a7(a[7],b[7],cs4, sum[7],carry[8],p[7]);
assign carryout = carry[8] | (p[4] & p[5] & p[6] & p[7] & cs4);
endmodule
Verilog Code for 16-bit Carry Skip Adder
module fulladd_p(a,b,carryin,sum,carryout,p);
input a, b, carryin; /* add these bits*/
output sum, carryout, p; /* results including propagate */
assign {carryout, sum} = a + b + carryin; /* compute the sum and carry */
assign p = a | b;
endmodule
module carryskip(a,b,carryin,sum,carryout);
input [15:0] a, b; /* add these bits */
input carryin; /* carry in*/
output [15:0] sum; /* result */
output carryout;
wire [16:1] carry; /* transfers the carry between bits */
wire [15:0] p; /* propagate for each bit */
wire cs4,cs5,cs6,cs7; /* final carry for first group */
fulladd_p a0(a[0],b[0],carryin,sum[0],carry[1],p[0]);
fulladd_p a1(a[1],b[1],carry[1],sum[1],carry[2],p[1]);
fulladd_p a2(a[2],b[2],carry[2],sum[2],carry[3],p[2]);
fulladd_p a3(a[3],b[3],carry[3],sum[3],carry[4],p[3]);
assign cs4 = carry[4] | (p[0] & p[1] & p[2] & p[3] & carryin);
fulladd_p a4(a[4],b[4],cs4, sum[4],carry[5],p[4]);
fulladd_p a5(a[5],b[5],cs4, sum[5],carry[6],p[5]);
fulladd_p a6(a[6],b[6],cs4, sum[6],carry[7],p[6]);
fulladd_p a7(a[7],b[7],cs4, sum[7],carry[8],p[7]);
assign cs5= carry[8] | (p[4] & p[5] & p[6] & p[7] & cs4);
fulladd_p a8(a[8],b[8],cs5, sum[8],carry[9],p[8]);
59
fulladd_p a9(a[9],b[9],cs5, sum[9],carry[10],p[9]);
fulladd_p a10(a[10],b[10],cs5, sum[10],carry[11],p[10]);
fulladd_p a11(a[11],b[11],cs5, sum[11],carry[12],p[11]);
assign cs6= carry[12] | (p[8] & p[9] & p[10] & p[11] & cs5);
fulladd_p a12(a[12],b[12],cs6, sum[12],carry[13],p[12]);
fulladd_p a13(a[13],b[13],cs6, sum[13],carry[14],p[13]);
fulladd_p a14(a[14],b[14],cs6, sum[14],carry[15],p[14]);
fulladd_p a15(a[15],b[15],cs6, sum[15],carry[16],p[15]);
assign carryout= carry[16] | (p[12] & p[13] & p[14] & p[15] & cs6);
endmodule

DESIGN AND PERFORMANCE ANALYSIS OF BINARY ADDERS_edited

  • 1.
    1 DESIGN AND PERFORMANCE ANALYSISOF BINARY ADDERS A project report submitted towards partial fulfillment of the requirements for the degree of Bachelor in Technology in Electronics and Telecommunication Engineering By RAHUL HANSDA (11010245) SHITAL PRASAD BADAIK (11010240), & MADHU MANASI PATI (11011468), of 7th semester Under the guidance of Dr. Kabiraj Sethi VEER SURENDRA SAI UNIVERSITY OF TECHNOLOGY, BURLA, ODISHA NOVEMBER-2014
  • 2.
    2 VEER SURENDRA SAIUNIVERSITY OF TECHNOLOGY, BURLA CERTIFICATE This is to certify that the project entitled “DESIGN AND PERFORMANCE ANALYSIS OF BINARY ADDERS” is carried out by Rahul Hansda(11010245) ,Shital Prasad Badaik(11010240) , Madhu Manasi Pati(11011468), and of the Department of Electronics and Telecommunication Engineering, Veer Surendra Sai University of Technology, Burla by a the virtue of the diligence and adherence to my guidance and advice during the academic year 2014-2015. Dr. D. Mishra Dr.Kabiraj Sethi Head Of Department, Assistant Professor, El. & Telecomm. Engg El. & Telecomm. Engg VSSUT, Burla VSSUT, Burla
  • 3.
    3 VEER SURENDRA SAIUNIVERSITY OF TECHNOLOGY, BURLA CERTIFICATE OF APPROVAL* This project entitled “DESIGN AND PERFORMANCE ANALYSIS OF BINARY ADDERS” submitted by Rahul Hansda(11010245),Shital Prasad Badaik(11010240), Madhu Manasi Pati(11011468), to Veer Surendra Sai University of Technology, Burla has been examined by us. It is found fit and approved for the degree of Bachelor of Technology. INTERNAL EXAMINER EXTERNAL EXAMINER *Only in casethe project is approved
  • 4.
    4 ACKNOWLEDGEMENT We feel honouredof this opportunity to express deep sense of gratitude to our guide and acknowledge our indebtedness to Dr. Kabiraj Sethi, Asst. Professor in Department of Electronics and Tele-communication Engineering for assisting us to select the given project, giving valuable guidance, encouragement and effort guiding us throughout our project. We also thank our friends for their support and help they had rendered us through the preparation of the project. Rahul Hansda (11010245) ETC, 7th Semester Shital Prasad Badaik (11010240) ETC, 7th Semester Madhu Manasi Pati (11011468) ETC, 7th Semester
  • 5.
    5 ABSTRACT Adders are oneof the most widely implemented blocks of microprocessor chips and digital components in the digital integrated circuit design. They are the necessary part of Digital Signal Processing (DSP) applications. With the advances in technology, researchers have tried and are trying to design adders which offer either high speed, low power consumption, less area or the combination of them. Every adder generates a carry value that has to be propagated through the circuit within a series of adders. This contributes largely to the critical path delay of the circuit. By reducing the number of stages the carry has to be propagated, the delay in the circuit can be reduced. The required sum is selected using a multiplexer. This project deals with the design of various adders such as Ripple Carry Adder (RCA), Carry Skip Adder (CSkA), Carry Increment Adder (CIA), Carry Look Ahead Adder (CLAA), Carry Save Adder (CSA), Carry Select Adder (CSlA), are discussed and the performance parameters of adders such as area and delay are determined and compared. Various adders are designed using Verilog HDL. Then, they are simulated and synthesized using Xilinx ISE 8.2i for Spartan 3 family device with speed grade -5.
  • 6.
    6 CONTENTS CHAPTER 1 1. Introduction CHAPTER2 2.0 Binary adders 2.0.1 Half adder 2.0.2 Full Adder 2.1 Types of adders 2.1.1 Ripple Carry Adder 2.1.2 Carry Look Ahead Adder 2.1.3 Carry Select Adder 2.1.4 Carry Save Adder 2.1.5 Carry Increment adder 2.1.6 Carry Skip Adder CHAPTER 3 Designof Adders 3.1 Designof Ripple Carry Adder 3.1.1 Design of 4-bit Ripple Carry Adder 3.1.2 Design of 8-bit Ripple Carry Adder 3.1.3 Design of 16-bit Ripple Carry Adder 3.2 Designof Carry-Look Ahead Carry Adder 3.2.1 Design of 4-bit Carry-Look Ahead Carry Adder 3.2.2 Design of 8-bit-Carry-Look Ahead Carry Adder 3.2.3 Design of 16-bit-Carry-Look Ahead Carry Adder 3.3 Designof Carry SelectAdder 3.3.1 Design of 4-bit Carry Select Adder 3.3.2 Design of 8-bit Carry Select Adder 3.3.3 Design of 16-bit Carry Select Adder 3.4 Designof Carry Skip Adder 3.4.1 Design of 4-bit Carry Skip Adder 3.4.2 Design of 8-bit Carry Skip Adder 3.4.3 Design of 16-bit Carry Skip Adder
  • 7.
    7 3.5 Designof CarryIncrement Adder 3.5.1 Design of 4-bit Carry Increment Adder 3.5.2 Design of 8-bit Carry Increment Adder 3.5.3 Design of 16-bit Carry Increment Adder 3.6 Designof Carry Save Adder 3.6.1 Design of 4-bit Carry Save Adder 3.6.2 Design of 8-bit Carry Save Adder 3.6.3 Design of 16-bit Carry Save Adder CHAPTER 4 Discussion and Results CHAPTER 5 Conclusion References Bibliography Appendix
  • 8.
    8 LIST OF FIGURES 1.Figure 2.1 Half Adder logic diagram 2. Table 1.Truth Table for Half Adder 3. Figure2. 3 Full Adder circuit 4. Table 2.Truth Table for Full Adder circuit 5. Figure2. 3 Full Adder circuit 6. Figure 2.4 Truth Table for Full Adder cir 7. Fig. 2.5 Architecture of Ripple Carry Adder (RCA) 8. Figure 2.6 Carry Look Ahead Adder 9. Figure 2.7 Flowchart of Carry look Ahead Adder 10. Figure 2.8 Carry Select Adder 11. Fig. 2.9 Carry Save Adder (CSA) 12. Fig. 2.10 Carry Increment Adder 13. Fig 2.11 Carry Skip Adder 14. Table-3: Performance analysis of adders
  • 9.
    9 Chapter1 1. INTRODUCTION The objectiveof this project is to design different architectures of adders and to study their respective performance, cost and design time. Adders are being used extensively in many processor architectures and computational units. It is a vital part in any processor or chip. By reducing the area occupied by these adders, the critical path delay can also be reduced. This can be done by implementing different designs of these adders. The ultimate aim of reducing the area and design is to optimize the cost of manufacture and improve the efficiency of the processor. Every adder generates a carry value that has to be propagated through the circuit within a series of adders. This contributes largely to the critical path delay of the circuit. By reducing the number of stages the carry has to be propagated, the delay in the circuit can be reduced. This can be done by implementing different architectures of the adder design and by incorporating varied logic to propagate the carry through the least number of stages possible. One by looking ahead of several blocks, i.e., by identifying where the actual output is and by delivering the carry signal right to that stage or by calculating the sum before the propagation is started. The required sum is selected using a multiplexer. In the above cases, the carry signal is not propagated through more than three stages which reduce the delay in the circuit. The various designs of adders are explained as follows. In this project, we implement the following adders:  Carry Ripple Adder  Carry Skip Adder  Carry Select Adder  Carry Look Ahead adder  Carry Save Adder  Carry Increment Adder The above designs are verified by performing the following steps  RTL design using synthesis  Logic simulation using Xilinx simulator  Place and Route for power analysis  Synthesis report for area and delay
  • 10.
    10 Chapter 2 BINARY ADDERS Inelectronics, an adder or summer is a digital circuit that performs addition of numbers. In many computers and other kinds of processors, adders are used not only in the arithmetic logic unit(s), but also in other parts of the processor, where they are used to calculate addresses, table indices, and similar operations. Although adders can be constructed for many numerical representations, such as binary- coded decimal or excess-3, the most common adders operate on binary numbers, hence named Binary Adders. Starting with the basic blocks of adder circuits-Half Adder and Full Adder we shall see how complex adder circuits are designed using these basic blocks. Half –Adder: The half adder adds two single binary digits A and B. It has two outputs, sum (S) and carry (C). The carry signal represents an overflow into the next digit of a multi-digit addition. The value of the sum is 2C + S. The simplest half-adder design, pictured on the right, incorporates an XOR gate for S and an AND gate for C. The half adder adds two input bits and generates a carry and sum, which are the two outputs of a half adder. Figure 2.1 Half Adder logic diagram Figure2.2 Truth Table for Half Adder Full Adder: A full adder adds binary numbers and accounts for values carried in as well as out. A one-bit full adder adds three one-bit numbers, often written as A, B, and Cin; A and B are the operands, and Cin is a bit carried in from the previous stage. The circuit produces a two-bit output, output carry and sum typically represented by the signals Cout and S. Input Output A B C S 0 0 0 0 0 1 0 1 1 0 0 1 1 1 1 0
  • 11.
    11 A full addercan be implemented in many different ways such as with a custom transistor- level circuit or composed of other gates. One example implementation is with and Figure2. 3 Full Adder circuit Figure 2.4 Truth Table for Full Adder circuit Ripple Carry Adder: Ripple Carry Adder (RCA) is a basic adder which works on basic addition principle [1]. The architecture of RCA is shown in Fig 2.5. Fig. 2.5 Architecture of Ripple Carry Adder (RCA) RCA contains series structure of Full Adders (FA); each FA is used to add two bits along with carry bit. The carry generated from each full adder is given to next full adder and so on. Hence, the carry is propagated in a serial computation. Hence, delay is more as the number of bits is increased in RCA. Carry Look-Ahead Adder: Carry Look Ahead (CLA) design is based on the principle of looking at lower adder bits of argument and addend if higher orders carry generated. This adder reduces the carry delay by reducing the number of gates through which a carry signal must propagate. As shown in Fig 2.5, in the generation and propagation stage, the generation values, propagation values are computed. Internal carry generation is calculated in second stage. And in final stage, the sum is calculated. The flow chart of CLA is given in Fig 2.5 and the architecture of CLA is given in Fig 2.6. Input A 0 0 0 0 1 1 1 1 B 0 0 1 1 0 0 1 1 Cin 0 1 0 1 0 1 0 1 Output Cout 0 0 0 1 0 1 1 1 S 0 1 1 0 1 0 0 1
  • 12.
    12 Figure 2.5 CarryLook Ahead Adder Figure 2.6 Flowchart of Carry look Ahead Adder Carry Select Adder: Carry Select Adder (CSlA) architecture consists of independent generation of sum and carry i.e. Cin=1 and Cin=0 are executed parallelly. Depending upon Cin, the external multiplexers select the carry to be propagated to next stage. Further, based on the carry input, the sum will be selected. Hence, the delay is reduced. However, the structure is increased due to the complexity of multiplexers. The architecture of CSlA is illustrated in Fig. 2.7 Figure 2.7 Carry Select Adder 4
  • 13.
    13 Carry Save Adder: InCarry Save Adder (CSA), three bits are added parallelly at a time. In this scheme, the carry is not propagated through the stages. Instead, carry is stored in present stage, and updated as addend value in the next stage. Hence, the delay due to the carry is reduced in this scheme. The architecture of CSA is shown in Fig 2.8. Fig. 2.8 Carry Save Adder (CSA) Carry Increment Adder: The design of Carry Increment Adder (CIA) consists of RCA’s and incremental circuitry. The incremental circuit can be designed using HA’s in ripple carry chain with a sequential order. The addition operation is done by dividing total number of bits in to group of 4bits and addition operation is done using several 4bit RCA’s. The architecture of CIA is shown in Fig 2.9 Fig. 2.9 Carry Increment Adder Carry Skip Adder: As the name indicates, Carry Skip Adder (CSkA) uses skip logic in the propagation of carry. It is designed to speed up the addition operation by adding a propagation of carry bit around a portion of entire adder. The carry-in bit designated as Ci. The output of RCA (the last stage) is Ci+4. The Carry Skip circuitry consists of two logic gates. AND gate accepts the carry-in bit and compares it with the group of propagated signals. Pi, Pi+3= (Pi+3)*(Pi+2)*(Pi+1)*Pi & Carry= Ci+4 + (Pi, i+3)* Ci
  • 14.
    14 The architecture ofCSkA is shown in Fig 2.10 Fig 2.10: Carry Skip Adder
  • 15.
    15 Chapter 3 DESIGN OFBINARY ADDER 3.1 Design of Ripple Carry Adder 3.1.1 Design of 4 bit Ripple Carry Adder The RTL design of Ripple Carry adder uses input vector a, b, and carry input Cin and output vector i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 4-bit Ripple Carry Adder is depicted below. a. RTL Schematic Design b.Xilinx ISE simulator result Considering the following data: Input Vector 1: 9, Input Vector 2: 11 and Carry Input: 2 We have theoretical valueof S: 20 The samecan be observed in thefollowing simulation result depicted below for a 4-bit RCA.
  • 16.
    16 3.1.2 Design of8 bit Ripple Carry Adder The RTL design of Ripple Carry adder uses input vector a, b, and carry input Cin and output vector i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 8-bit Ripple carry adder is depicted below. a. RTL Schematic Design b. Xilinx ISE Simulator result: Considering the following data: Input Vector 1: 29, Input Vector 2: 7 and Carry Input: 0 We have theoretical valueof S: 37 The samecan be observed in thefollowing simulation result depicted below for a 8-bit RCA.
  • 17.
    17 3.1.3 Design of16 bit Ripple Carry Adder The RTL design of Ripple Carry adder uses input vector a, b, and carry input Cin and output vector i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 16 -bit Ripple Carry Adder is depicted below. a. RTL Schematic Design b. Xilinx ISE Simulator result: Considering the following data: Input Vector 1: 60598,Input Vector 2: 21058 and Carry Input:0 We have theoretical valueof S: 16220 The samecan be observed in thefollowing simulation result depicted below for a 16-bit RCA.
  • 18.
    18 3.2 Design ofCarry Look Ahead Adder 3.2.1 Design of 4 bit Carry Look Ahead Adder The RTL design of Carry look ahead adder uses input vector a, b, and carry input Cin and output vector i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 4 -bit Carry Look Ahead adder is depicted below. a. RTL Schematic Design 9 b. Xilinx ISE Simulator result: Considering the following data: Input Vector 1: 0011,Input Vector 2: 0010 and Carry Input: 1 We have theoretical valueof S: 4’b0110 The samecan be observed in thefollowing simulation result depicted below for a 4-bit CLA.
  • 19.
    19 3.2.2 Design of8 bit Carry Look Ahead Adder The RTL design of Carry look ahead adder uses input vector a, b, and carry input Cin and output vector i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 8 -bit Carry Look Ahead adder is depicted below. a. RTL Schematic Design b. Xilinx ISE Simulator result Considering the following data: Input Vector 1: 234,Input Vector 2: 224 and Carry Input: 0 We have theoretical valueof S:203 The samecan be observed in thefollowing simulation result depicted below for a 8-bit CLA.
  • 20.
    20 3.2.2 Design of16 bit Carry Look Ahead Adder The RTL design of Carry look ahead adder uses input vector a, b, and carry input Cin and output vector i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 16 -bit Carry Look Ahead adder is depicted below. a. RTL Schematic Design b. Xilinx ISE Simulator result: Considering the following data: Input Vector 1: 59953,Input Vector 2: 3 and Carry Input: 0 We have theoretical valueof S: 59957 The samecan be observed in thefollowing simulation result depicted below for a 16-bit CLA.
  • 21.
    21 3.3 Design ofCarry Select Adder 3.3.1 Design of 4 bit Carry Select Adder The RTL design of Carry Select adder uses input vector a, b, and carry input Cin and output vector i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 4-bit Carry Select adder is depicted below. a. RTL Schematic Design b.Xilinx ISE Simulator result: Considering the following data: Input Vector 1: 14, Input Vector 2: 15 and Carry Input:0 We have theoretical valueof S:14 The samecan be observed in thefollowing simulation result depicted below for a 4-bit CSA.
  • 22.
    22 3.3.2 Design of8 bit Carry Select Adder The RTL design of Carry Select adder uses input vector a, b, and carry input Cin and output vector i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 4-bit Carry Look Ahead adder is depicted below. a. RTL Schematic Design b. Xilinx ISE simulator result Considering the following data: Input Vector 1: 29, Input Vector 2: 7 and Carry Input: 0 We have theoretical valueof S: 37 The samecan be observed in thefollowing simulation result depicted below for a 8-bit CSA.
  • 23.
    23 3.3.3 Design of16 bit Carry Select Adder The RTL design of Carry Select adder uses input vector a, b, and carry input Cin and output vector i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 16 -bit Carry Select adder is depicted below. a. RTL Schematic Design b. Xilinx ISE simulator result Considering the following data: Input Vector 1: 7609,Input Vector 2: 7 and Carry Input: 0 We have theoretical valueof S: 7617 The samecan be observed in thefollowing simulation result depicted below for a 16-bit CSA.
  • 24.
    24 3.4 Design ofCarry Save Adder 3.4.1 Design of 4 bit Carry Select Adder The RTL design of Carry Select adder uses input vector a, b, and carry input Ci and output vector i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 4-bit Carry Select adder is depicted below. a. RTL Schematic Design b. Xilinx ISE simulator result Considering the following data: Input Vector 1: 0011,Input Vector 2: 0110 and Carry Input: 0 We have theoretical valueof S: 4’b1001 The samecan be observed in thefollowing simulation result depicted below for a 4-bit CSA.
  • 25.
    25 3.4.2 Design of8 bit Carry Select Adder The RTL design of Carry Select adder uses input vector a, b, and carry input Cin and output vector i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 8-bit Carry Select Adder is depicted below. a. RTL Schematic Design b. Xilinx ISE simulator result Considering the following data: Input Vector 1: 00011110,Input Vector 2: 00110001 and Carry Input:1 We have theoretical valueof S: 01010000 The samecan be observed in thefollowing simulation result depicted below for a 8-bit CSA.
  • 26.
    26 3.4.3 Design of16 bit Carry Select Adder The RTL design of Carry Select adder uses input vector a, b, and carry input Cin and output vector i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 16-bit Carry Select adder is depicted below. a. RTL Schematic Design b. Xilinx ISE simulator result: Considering the following data: Input Vector 1: 0011001000100010,Input Vector 2: 0000110011000001 and Carry Input:0 We have theoretical valueof S: 0011111011100011 The samecan be observed in thefollowing simulation result depicted below for a 16-bit CSA.
  • 27.
    27 3.5 Design ofCarry Increment Adder 3.5.1 Design of 4 bit Carry Increment Adder The RTL design of Carry Increment adder uses input vector a, b, and carry input Cin and output vector i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 4 -bit Select adder is depicted below. a. RTL Schematic Design b. Xilinx ISE simulator results: Considering the following data: Input Vector 1: 15, Input Vector 2: 15 and Carry Input: 0 We have theoretical valueof S: 15 The samecan be observed in thefollowing simulation result depicted below for a 4-bit CIA. 3.5.2 Design of 8 bit Carry Increment Adder
  • 28.
    28 The RTL designof Carry Increment adder uses input vector a, b, and carry input Cin and output vector i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 8 -bit Carry Increment adder is depicted below. a. RTL Schematic Design b. Xilinx ISE simulator result Considering the following data: Input Vector 1:29, Input Vector 2: 3 and Carry Input: 0 We have theoretical valueof S: 33 The samecan be observed in thefollowing simulation result depicted below for a 8-bit CIA.
  • 29.
    29 3.5.3 Design of16- bit Carry Increment Adder The RTL design of Carry Increment adder uses input vector a, b, and carry input Cin and output vector i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 16-bit Carry Increment adder is depicted below. a. RTL Schematic Design b. Xilinx ISE simulator result Considering the following data: Input Vector 1: 385,Input Vector 2: 3549 and Carry Input: 0 We have theoretical valueof S: 17’b 0042 The samecan be observed in thefollowing simulation result depicted below for a 16-bit CIA.
  • 30.
    30 3.6 Design ofCarry Skip Adder 3.6.1 Design of 4- bit Carry Skip Adder The RTL design of Carry Skip adder uses input vector a, b, and carry input Cin and output vector i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 4-bit Carry Skip adder is depicted below. a. RTL Schematic Design b. Xilinx ISE simulator result Considering the following data: Input Vector 1: 5, Input Vector 2:7 and Carry Input: 0 We have theoretical valueof S: 13 The samecan be observed in thefollowing simulation result depicted below for a 4-bit CSA.
  • 31.
    31 3.6.2 Design of8- bit Carry Skip Adder The RTL design of Carry Skip adder uses input vector a, b, and carry input Cin and output vector i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 8-bit Carry Skip adder is depicted below. a. RTL Schematic Design b. Xilinx ISE simulator result: Considering the following data: Input Vector 1: 66, Input Vector 2: 135 and Carry Input: 1 We have theoretical valueof S: 202 The samecan be observed in thefollowing simulation result depicted below for a 8-bit CSA.
  • 32.
    32 3.6.2 Design of16- bit Carry Skip Adder The RTL design of Carry Skip adder uses input vector a, b, and carry input Cin and output vector i.e. output sum vector is denoted by S and final carry output by Cout. The schematic diagram of 4-bit Carry Skip adder is depicted below. a. RTL Schematic Design b. Xilinx ISE simulator result: Considering the following data: Input Vector 1: 7609,Input Vector 2: 65532 and Carry Input: 0 We have theoretical valueof S: 7606 The samecan be observed in thefollowing simulation result depicted below for a 16-bit CSA.
  • 33.
    33 Results and Discussion Thereare six different complex adder circuit design which have been developed using Verilog-HDL and synthesized in the ISE simulator tool using Xilinx ISE 8.2.Table I exhibits post simulation results of the conventional adder circuits in terms of Propagation delay (in ns), Area (in terms of No. of Slices and LUTs) and Power (in mW).The Area Indicated the total cell area of the design; the total power is sum of dynamic power, internal power, net power and leakage power. The delay is the critical path delay of the adder circuits [2].  The results shows that for a 4-bit adder circuit, the Carry Increment Adder circuit has higher speed and minimum area when compared to other conventional adder circuits depicted by the figure (2.9).  The results shows that for a 8-bit adder circuit, the Carry Increment Adder circuit has higher speed depicted by figure(2.9) and the Carry Look Ahead Adder has minimum area when compared to other conventional adder circuits depicted by the figure (2.5).  The results shows that for a 16-bit adder circuit, the Carry Skip Adder circuit has higher speed and minimum area when compared to other conventional adder circuits depicted by the figure (2.10). The marginal improvement in speed increases with the rise in word size of the adder. This shows very well that the design can be incorporated into complex VLSI Design and DSP applications in order to increase the operating speed of the circuits without compromising in terms of area and path delay due to large carry chains.
  • 34.
    34 T A BU L A T I O N The Tabulation compares adder circuits for the area for different word sizes. It shows that the area of ( ) adder circuit occupies minimum area when compared to other conventional adder counterparts. The amount of area gain achieved in ( ) adder circuit increases with word-size of the adders. Table-3: Performance analysis of adders 4-bit 8-bit 16-bit Types of Adders Area Pow er(in mW) Dela y(in ns) Area Powe r(in mW) Del ay ( in ns) Area Powe r(in mW) Del ay (in ns) Ripple Carry Adder Slice-04 LUT-08 I/O-14 56.0 5 13.90 2 Slice- 08 LUT-15 I/O-26 56.05 18.6 46 Slice- 18 LUT- 32 I/O-50 56.05 33.3 78 Carry Look Ahead Adder Slice-04 LUT-08 I/O-14 56.0 5 11.89 7 Slice- 08 LUT-15 I/O-26 56.05 15.7 49 Slice- 19 LUT- 33 I/O-50 56.05 26.4 86 Carry Select Adder Slice-06 LUT-11 I/O-14 56.0 5 11.54 7 Slice- 13 LUT-24 I/O-26 56.05 14.9 03 Slice- 30 LUT- 56 I/O-50 56.05 19.9 34 Carry Save Adder Slice-03 LUT-06 I/O-14 56.0 5 9.142 Slice- 13 LUT-23 I/O-26 56.05 15.0 96 Slice- 31 LUT- 54 I/O-50 56.05 18.4 85 Carry Increment Adder Slice-03 LUT-06 I/O-14 56.0 5 9.043 Slice- 11 LUT-20 I/O-27 56.05 14.1 43 Slice- 24 LUT- 42 I/O-51 56.05 23.2 49 Carry Skip Adder Slice-04 LUT-08 I/O-14 56.0 5 13.52 1 Slice- 09 LUT-15 I/O-26 56.05 15.3 45 Slice- 14 LUT- 25 I/O-50 56.05 18.5 52
  • 35.
    35 Conclusion: The selected addercircuit with minimum area, power and delay is Carry Increment Adder for 4-bit, in case of an 8-bit, there is a competence between Carry Look Ahead and Carry Increment Adder and in case of a 16-bit, Carry Skip adder has minimum area and delay which proves to be easy solution in improving the speed of the adder circuit over other conventional adder circuits in discussion suffering from disadvantage of either occupying more number of slices or look-up tables per unit of cell or have highest minimum propagation delay owing to their critical carry path for same power (in mW).The selected adder circuit is also found to have comparatively less power consumption in comparison to other adder circuits. Hence it can be concluded on our part that above respective adder circuit on the basis of different word size can be used to speed up the final addition in parallel multiplier circuits and other architectures which uses adder circuits no doubt, exhibiting maximum efficiency. The structure has been synthesized using Xilinx ISE 8.2i and simulated using ISE simulator tool.
  • 36.
    36 References: 1. A VeryFast and Low Power Carry Select Adder Circuit -Samiappa Sakthikumaran1, S. Salivahanan, V. S. Kanchana Bhaaskaran2, V. Kavinilavu, B. Brindha and C. Vinoth, Department of Electronics and Communication Engineering,SSN College of Engineering, Kalavakkam, (Off)Chennai sakthikumaran87@gmail.com1, vskanchana@hotmail.com2 2. International Journal of Science and Research (IJSR), Simulation of Different bit Carry-Skip Adder in Verilog ,Sangeeta Rani1, Sachin Kumar2 1M. Tech Student, Department of Electronics & Communication,2Faculty, Department of Electronics & Communication, Meri College of Engineering & Technology, Sampla,Haryana, India 3. Efficient Implementation of Carry Save Adder, Sabyasachi Bhowmick , Mr. P. Mohan Kumar Student – Department of Electronics & Communication Engineering ; LPU ; Punjab, India Assistant Professor – Dept. of Electronics & Communication Engineering ; LPU ; Punjab, India Sabyasachi0011@gmail.com Mohan.15771@lpu.co.in 4.International Journal of Computer Science and Mobile Computing, IJCSMC, Vol. 2, Issue. 9, September 2013,RESEARCH ARTICLE, Design and Performance Analysis of Various Adders using Verilog Maroju SaiKumar1, Dr. P. Samundiswary2 ¹Student, Department of Electronics Engineering, Pondicherry University, Pondicherry, India;²Assistant Professor, Department of Electronics Engineering, Pondicherry University, Pondicherry, India 1 saikumar488@gmail.com; 2 samundiswary_pdy@yahoo.com 5 http://en.wikipedia.org/wiki/Adder_%28electronics%29 6. 1999 Computer Arithmetic –Algorithms and HardwareDesigns, Behrooz Parhami,Dept. of Electrical and Computer Engineering, University of California, Santa Barbara 7. Digital Design 3rd Edition –M. Morris Mano
  • 37.
    37 Appendix:A HDL Codes Verilog Codefor 4-bit Ripple Carry Adder module rip2(s,cout,a,b,cin); //sub module for 4 bit Ripple carry adder input [3:0]a; input [3:0]b; input cin; output cout; output [3:0]s; wire c2,c3,c4,cout; fa m1(s[0],c2,a[0],b[0],cin); fa m2(s[1],c3,a[1],b[1],c2); fa m3(s[2],c4,a[2],b[2],c3); fa m4(s[3],cout,a[3],b[3],c4); endmodule module fa(s,cout,a,b,cin); //sub module for Full adder input a,b,cin; output s,cout; wire w1,w2,w3; ha m1(w1,w2,a,b); ha m2(s,w3,w1,cin); or m3(cout,w2,w3); endmodule module ha(s,cout,a,b); //sub module for Half adder input a,b; output s,cout; xor m1(s,a,b); and m2(cout,a,b); endmodule Verilog Code for 8-bit Ripple Carry Adder module rip(s,cout,a,b,cin);
  • 38.
    38 //main module of8 bit Ripple carry adder input [7:0]a; input [7:0]b; input cin; output cout; output [7:0]s; wire c4,c8,cout; rip2 m1(s[3:0],c4,a[3:0],b[3:0],cin); rip2 m2(s[7:4],c8,a[7:4],b[7:4],cout); endmodule module rip2(s,cout,a,b,cin); //sub module for 4 bit Ripple carry adder input [3:0]a; input [3:0]b; input cin; output cout; output [3:0]s; wire c2,c3,c4,cout; fa m1(s[0],c2,a[0],b[0],cin); fa m2(s[1],c3,a[1],b[1],c2); fa m3(s[2],c4,a[2],b[2],c3); fa m4(s[3],cout,a[3],b[3],c4); endmodule module fa(s,cout,a,b,cin); //sub module for Full adder input a,b,cin; output s,cout; wire w1,w2,w3; ha m1(w1,w2,a,b); ha m2(s,w3,w1,cin); or m3(cout,w2,w3); endmodule module ha(s,cout,a,b); //sub module for Half adder input a,b; output s,cout; xor m1(s,a,b); and m2(cout,a,b);
  • 39.
    39 endmodule Verilog Code for16-bit Ripple Carry Adder module rip(s,cout,a,b,cin); //main module of 16 bit Ripple carry adder input [15:0]a; input [15:0]b; input cin; output cout; output [15:0]s; wire c4,c8,c12,cout; rip2 m1(s[3:0],c4,a[3:0],b[3:0],cin); rip2 m2(s[7:4],c8,a[7:4],b[7:4],c4); rip2 m3(s[11:8],c12,a[11:8],b[11:8],c8); rip2 m4(s[15:12],cout,a[15:12],b[15:12],c12); endmodule module rip2(s,cout,a,b,cin); //sub module for 4 bit Ripple carry adder input [3:0]a; input [3:0]b; input cin; output cout; output [3:0]s; wire c2,c3,c4,cout; fa m1(s[0],c2,a[0],b[0],cin); fa m2(s[1],c3,a[1],b[1],c2); fa m3(s[2],c4,a[2],b[2],c3); fa m4(s[3],cout,a[3],b[3],c4); endmodule module fa(s,cout,a,b,cin); //sub module for Full adder input a,b,cin; output s,cout; wire w1,w2,w3; ha m1(w1,w2,a,b); ha m2(s,w3,w1,cin); or m3(cout,w2,w3); endmodule
  • 40.
    40 module ha(s,cout,a,b); //sub modulefor Half adder input a,b; output s,cout; xor m1(s,a,b); and m2(cout,a,b); endmodule Appendix:B Verilog code for 4 bit Carry Lookahead Adder //4-bit ripple carry adder module RCA(A,B,Ci,So,Co); //outputs output [3:0] So ; output Co ; //inputs input [3:0] A ; input [3:0] B ; input Ci ; //internal wiring wire c1,c2,c3,c4; wire g0,g1,g2,g3; wire p0,p1,p2,p3; //g = A * B assign g0=A[0]&B[0]; assign g1=A[1]&B[1]; assign g2=A[2]&B[2]; assign g3=A[3]&B[3]; //p = A + B assign p0=A[0]|B[0]; assign p1=A[1]|B[1]; assign p2=A[2]|B[2]; assign p3=A[3]|B[3]; //c = g + (p * Ci)... assign c1=g0|(p0&Ci); assign c2=g1|(p1&g0)|(p1&p0&Ci); assign c3=g2|(p2&g1)|(p2&p1&g0)|(p2&p1&p0&Ci); assign c4=g3|(p3&g2)|(p3&p2&g1)|(p3&p2&p1&g0)|(p3&p2&p1&p0&Ci); assign Co=c4;
  • 41.
    41 //S = gXOR p XOR C assign So[0]=g0^p0^Ci; assign So[1]=g1^p1^c1; assign So[2]=g2^p2^c2; assign So[3]=g3^p3^c3; endmodule Verilog Code for 8-bit Ripple Carrylookahead Adder module CLA8(sum,carryout,A_in,B_in,carryin); output [7:0] sum; output carryout; input [7:0] A_in; input [7:0] B_in; input carryin; wire [7:0] sum; wire carryout; wire [2:0] carry; cla4 c1(sum[3:0],carry[0],A_in[3:0],B_in[3:0],carryin); cla4 c2(sum[7:4],carry[1],A_in[7:4],B_in[7:4],carry[0]); //cla4 c3(sum[11:8],carry[2],A_in[11:8],B_in[11:8],carry[1]); //cla4 c4(sum[15:12],carryout,A_in[15:12],B_in[15:12],carry[2]); endmodule //***************** 4-bit carry look-ahead adder ********************** module cla4(s,cout,i1,i2,c0); output [3:0] s; //summation output cout; //carryout input [3:0] i1; //input1 input [3:0] i2; //input2 input c0; wire [3:0] s; wire cout; wire [3:0] g; wire [3:0] p; wire [3:1] c; assign g[3:0]=i1[3:0] & i2[3:0]; //carry generation assign p[3:0]=i1[3:0] ^ i2[3:0]; //carry propagation assign c[1]=g[0] | (p[0] & c0); //calculate each stage carryout assign c[2]=g[1] | (g[0] & p[1]) | (p[0] & p[1] & c0); assign c[3]=g[2] | (g[1] & p[2]) | (g[0] & p[1] & p[2]) | (p[0] & p[1] & p[2] &
  • 42.
    42 c0); assign cout=g[3] |(g[2] & p[3]) | (g[1] & p[2] & p[3]) | (g[0] & p[1] & p[2] & p[3]) | (p[0] & p[1] & p[2] & p[3] & c0); assign s[0]=p[0]^c0; //calculate summation assign s[3:1]=p[3:1]^c[3:1]; endmodule Verilog Code for 16-bit Ripple Carrylookahead Adder module cla16(sum,carryout,A_in,B_in,carryin); output [15:0] sum; output carryout; input [15:0] A_in; input [15:0] B_in; input carryin; wire [15:0] sum; wire carryout; wire [2:0] carry; cla4 c1(sum[3:0],carry[0],A_in[3:0],B_in[3:0],carryin); cla4 c2(sum[7:4],carry[1],A_in[7:4],B_in[7:4],carry[0]); cla4 c3(sum[11:8],carry[2],A_in[11:8],B_in[11:8],carry[1]); cla4 c4(sum[15:12],carryout,A_in[15:12],B_in[15:12],carry[2]); endmodule //***************** 4-bit carry look-ahead adder ********************** module cla4(s,cout,i1,i2,c0); output [3:0] s; //summation output cout; //carryout input [3:0] i1; //input1 input [3:0] i2; //input2 input c0; //????? wire [3:0] s; wire cout; wire [3:0] g; wire [3:0] p; wire [3:1] c; assign g[3:0]=i1[3:0] & i2[3:0]; //carry generation assign p[3:0]=i1[3:0] ^ i2[3:0]; //carry propagation assign c[1]=g[0] | (p[0] & c0); //calculate each stage carryout assign c[2]=g[1] | (g[0] & p[1]) | (p[0] & p[1] & c0); assign c[3]=g[2] | (g[1] & p[2]) | (g[0] & p[1] & p[2]) | (p[0] & p[1] & p[2] &
  • 43.
    43 c0); assign cout=g[3] |(g[2] & p[3]) | (g[1] & p[2] & p[3]) | (g[0] & p[1] & p[2] & p[3]) | (p[0] & p[1] & p[2] & p[3] & c0); assign s[0]=p[0]^c0; //calculate summation assign s[3:1]=p[3:1]^c[3:1]; endmodule Appendix:C Verilog Code for 4-bit Carry Select Adder module csa(a,b,cin,sum,co); input [3:0]a; input [3:0]b; input cin; output [3:0]sum; output co; wire [3:0]sum; wire co; wire s1,c1,s2,c2,s3,c3,s4,s11,s44,c4,c11,s22,c22,s33,c33,c44; //assuming carry in 0 fa x1(a[0],b[0],0,s1,c1); fa x2(a[1],b[1],c1,s2,c2); fa x3(a[2],b[2],c2,s3,c3); fa x4(a[3],b[3],c3,s4,c4); //assuming carry in 1 fa x5(a[0],b[0],1,s11,c11); fa x6(a[1],b[1],c11,s22,c22); fa x7(a[2],b[2],c22,s33,c33); fa x8(a[3],b[3],c33,s44,c44); //select either carry 1 or 0 using carry out of FA //mux for sum select mux x9(s1,s11,cin,sum[0]); mux x10(s2,s22,cin,sum[1]); mux x11(s3,s33,cin,sum[2]); mux x12(s4,s44,cin,sum[3]); //mux for carry select mux x13(c4,c44,cin,co); endmodule //fa module
  • 44.
    44 module fa(a, b,c, sum, carry); input a; input b; input c; output sum; output carry; wire d,e,f; xor(sum,a,b,c); and(d,a,b); and(e,b,c); and(f,a,c); or(carry,d,e,f); endmodule //mux module module mux(a,b,s,q); input a; input b; input s; output q; wire q; assign q=s?b:a; endmodule Verilog Code for 8-bit Carry Select Adder module CSA_8bit(a,b,cin,sum,co); input [7:0]a; input [7:0]b; input cin; output [7:0]sum; output co; wire [7:0]sum; wire co; wire s1,c1,s2,c2,s3,c3,s4,s11,s44,c4,c11,s22,c22,s33,c33,c44; //assuming carry in 0 fa x1(a[1:0],b[1:0],0,s1,c1); fa x2(a[3:2],b3:2],c1,s2,c2); fa x3(a[5:4],b[5:4],c2,s3,c3); fa x4(a[7:6],b[7:6],c3,s4,c4); //assuming carry in 1
  • 45.
    45 fa x5(a[1:0],b[1:0],1,s11,c11); fa x6(a[3:2],b[3:2],c11,s22,c22); fax7(a[5:4],b[5:4],c22,s33,c33); fa x8(a[7:6], b[7:6],c33,s44,c44); //select either carry 1 or 0 using carry out of FA //mux for sum select mux x9(s1,s11,cin,sum[1:0]); mux x10(s2,s22,cin,sum[3:2]); mux x11(s3,s33,cin,sum[5:4]); mux x12(s4,s44,cin,sum[7:6]); //mux for carry select mux x13(c4,c44,cin,co); endmodule //fa module module fa(a, b, c, sum, carry); input a; input b; input c; output sum; output carry; wire d,e,f; xor(sum,a,b,c); and(d,a,b); and(e,b,c); and(f,a,c); or(carry,d,e,f); endmodule //mux module module mux(a,b,s,q); input a; input b; input s; output q; wire q; assign q=s?b:a; endmodule Verilog Code for 16-bit Carry Select Adder module csa16bit(a,b,cin,sum,co);
  • 46.
    46 input [15:0]a; input [15:0]b; inputcin; output [15:0]sum; output co; wire [15:0]sum; wire co; wire s1,c1,s2,c2,s3,c3,s4,s5,c5,s6,c6,s7,c7,s8,c8,s9,c9,s10,c10,s11,c11,s12,c12,s13,c13,s14,c14,s15,c 15,s16,c16, s111,s44,c32,c111,s22,c22,s33,c33,c44,s55,s88,c55,s66,c66,s77,c77,c88,s99,c99,s1010,c1010,s1 111,c1111,s1212,c1212,s1313,c1313,s1414,c1414,s1515,c1515,s1616,c1616; //assuming carry in 0 fa x1(a[0],b[0],0,s1,c1); fa x2(a[1],b[1],c1,s2,c2); fa x3(a[2],b[2],c2,s3,c3); fa x4(a[3],b[3],c3,s4,c4); fa x5(a[4],b[4],c4,s5,c5); fa x6(a[5],b[5],c5,s6,c6); fa x7(a[6],b[6],c6,s7,c7); fa x8(a[7],b[7],c7,s8,c8); fa x9(a[8],b[8],c8,s9,c9); fa x10(a[9],b[9],c9,s10,c10); fa x11(a[10],b[10],c10,s11,c11); fa x12(a[11],b[11],c11,s12,c12); fa x13(a[12],b[12],c12,s13,c13); fa x14(a[13],b[13],c13,s14,c14); fa x15(a[14],b[14],c14,s15,c15); fa x16(a[15],b[15],c15,s16,c16); //assuming carry 1 fa x17(a[0],b[0],1,s111,c111); fa x18(a[1],b[1],c111,s22,c22); fa x19(a[2],b[2],c22,s33,c33); fa x20(a[3],b[3],c33,s44,c44); fa x21(a[4],b[4],c44,s55,c55); fa x22(a[5],b[5],c55,s66,c66); fa x23(a[6],b[6],c66,s77,c77); fa x24(a[7],b[7],c77,s88,c88); fa x25(a[8],b[8],c88,s99,c99); fa x26(a[9],b[9],c99,s1010,c1010);
  • 47.
    47 fa x27(a[10],b[10],c1010,s1111,c1111); fa x28(a[11],b[11],c1111,s1212,c1212); fax29(a[12],b[12],c1212,s1313,c1313); fa x30(a[13],b[13],c1313,s1414,c1414); fa x31(a[14],b[14],c1414,s1515,c1515); fa x32(a[15],b[15],c1515,s1616,c1616); //select either carry 1 or 0 using carry out of FA //mux for sum select mux x33(s1,s111,cin,sum[0]); mux x34(s2,s22,cin,sum[1]); mux x35(s3,s33,cin,sum[2]); mux x36(s4,s44,cin,sum[3]); mux x37(s5,s55,cin,sum[4]); mux x38(s6,s66,cin,sum[5]); mux x39(s7,s77,cin,sum[6]); mux x40(s8,s88,cin,sum[7]); mux x41(s9,s99,cin,sum[8]); mux x42(s10,s1010,cin,sum[9]); mux x43(s11,s1111,cin,sum[10]); mux x44(s12,s1212,cin,sum[11]); mux x45(s13,s1313,cin,sum[12]); mux x46(s14,s1414,cin,sum[13]); mux x47(s15,s1515,cin,sum[14]); mux x48(s16,s1616,cin,sum[15]); //mux for carry select mux x49(c16,c1616,cin,co); endmodule //fa module module fa(a, b, c, sum, carry); input a; input b; input c; output sum; output carry; wire d,e,f; xor(sum,a,b,c); and(d,a,b); and(e,b,c);
  • 48.
    48 and(f,a,c); or(carry,d,e,f); endmodule //mux module module mux(a,b,s,q); inputa; input b; input s; output q; wire q; assign q=s?b:a; endmodule Appendix:D Verilog Code for 4-bit Carry Save Adder module csa4(a,b,ci,s,co); input [3:0]a; input [3:0]b; input ci; output co; output [3:0]s; wire [5:0]c; wire [3:0]stemp; //overall circuit FA x1(a[0],b[0],ci,s[0],c[0]); FA x2(a[1],b[1],c[0],s[1],c[1]); FA x3(a[2],b[2],1,stemp[0],c[2]); FA x4(a[3],b[3],c[2],stemp[1],c[3]); FA x5(a[2],b[2],1,stemp[2],c[4]); FA x6(a[3],b[3],c[4],stemp[3],c5); //conditional assignments assign s[2]= c[1]?stemp[0]:stemp[1]; assign s[3]= c[1]?stemp[2]:stemp[3]; assign co=c[1]?c[3]:c[5]; endmodule //FA module module FA(a,b,cin,s,co);
  • 49.
    49 input a,b,cin; output s,co; wired,e,f; xor (s,a,b,c); and (d,a,b); and (e,b,c); and (f,a,c); or (co,d,e,f); endmodule Verilog Code for 8-bit Carry Save Adder //4-bit ripple carry adder module RCA(A,B,Ci,So,Co); //outputs output [3:0] So ; output Co ; //inputs input [3:0] A ; input [3:0] B ; input Ci ; //internal wiring wire c1,c2,c3,c4; wire g0,g1,g2,g3; wire p0,p1,p2,p3; //g = A * B assign g0=A[0]&B[0]; assign g1=A[1]&B[1]; assign g2=A[2]&B[2]; assign g3=A[3]&B[3]; //p = A + B assign p0=A[0]|B[0]; assign p1=A[1]|B[1]; assign p2=A[2]|B[2]; assign p3=A[3]|B[3]; //c = g + (p * Ci)... assign c1=g0|(p0&Ci); assign c2=g1|(p1&g0)|(p1&p0&Ci); assign c3=g2|(p2&g1)|(p2&p1&g0)|(p2&p1&p0&Ci); assign c4=g3|(p3&g2)|(p3&p2&g1)|(p3&p2&p1&g0)|(p3&p2&p1&p0&Ci);
  • 50.
    50 assign Co=c4; //S =g XOR p XOR C assign So[0]=g0^p0^Ci; assign So[1]=g1^p1^c1; assign So[2]=g2^p2^c2; assign So[3]=g3^p3^c3; endmodule //8-bit carry save adder module csa8(A,B,Ci,So,Co); //outputs output [7:0] So; output Co; //inputs input [7:0] A,B; input Ci; //internal wiring wire [3:0] stemp1,stemp0; wire c4; wire c80,c81; //utilize RCA for CSA RCA RCAin(A[3:0],B[3:0],Ci,So[3:0],c4); RCA RCA1 (A[7:4],B[7:4],1'b1,stemp1,c81); RCA RCA0 (A[7:4],B[7:4],1'b0,stemp0,c80); //conditional assignments assign So[7:4] = c4?stemp1:stemp0; assign Co= c4?c81:c80; endmodule Verilog Code for 16-bit Carry Save Adder module CSA16(A,B,Ci,So,Co); input [15:0] A,B; input Ci; output [15:0] So; output Co; wire [7:0] stemp1,stemp0; wire c8; wire c160,c161; CSA8 CSA8in(A[7:0],B[7:0],Ci,So[7:0],c8 ); CSA8 CSA81 (A[15:8],B[15:8],1'b1,stemp1,c161);
  • 51.
    51 CSA8 CSA80 (A[15:8],B[15:8],1'b0,stemp0,c160); assignSo[15:8] = c8?stemp1:stemp0; assign Co= c8?c161:c160; endmodule //4-bit ripple carry adder module RCA (A,B,Ci,So,Co); //outputs output [3:0] So ; output Co ; //inputs input [3:0] A ; input [3:0] B ; input Ci ; //internal wiring wire c1,c2,c3,c4; wire g0,g1,g2,g3; wire p0,p1,p2,p3; //g = A * B assign g0=A[0]&B[0]; assign g1=A[1]&B[1]; assign g2=A[2]&B[2]; assign g3=A[3]&B[3]; //p = A + B assign p0=A[0]|B[0]; assign p1=A[1]|B[1]; assign p2=A[2]|B[2]; assign p3=A[3]|B[3]; //c = g + (p * Ci)... assign c1=g0|(p0&Ci); assign c2=g1|(p1&g0)|(p1&p0&Ci); assign c3=g2|(p2&g1)|(p2&p1&g0)|(p2&p1&p0&Ci); assign c4=g3|(p3&g2)|(p3&p2&g1)|(p3&p2&p1&g0)|(p3&p2&p1&p0&Ci); assign Co=c4; //S = g XOR p XOR C assign So[0]=g0^p0^Ci; assign So[1]=g1^p1^c1; assign So[2]=g2^p2^c2; assign So[3]=g3^p3^c3; endmodule
  • 52.
    52 //8-bit carry saveadder module CSA8(A,B,Ci,So,Co); //outputs output [7:0] So; output Co; //inputs input [7:0] A,B; input Ci; //internal wiring wire [3:0] stemp1,stemp0; wire c4; wire c80,c81; //utilize RCA for CSA RCA RCAin(A[3:0],B[3:0],Ci,So[3:0],c4); RCA RCA1 (A[7:4],B[7:4],1'b1,stemp1,c81); RCA RCA0 (A[7:4],B[7:4],1'b0,stemp0,c80); //conditional assignments assign So[7:4] = c4?stemp1:stemp0; assign Co= c4?c81:c80; endmodule Appendix:E Verilog Code for 4-bit Carry Increment Adder module cia4bit(a,b,cin,s,co); input [3:0]a; input [3:0]b; input cin; output [3:0]s; output co; wire [2:0]sum; wire c0,c1,c2,c3,c4,c5; //overall ckircuit description FA x1(a[0],b[0],0,s[0],c0); FA x2(a[1],b[1],c0,s[1],c1); FA x3(a[2],b[2],0,s[2],c2); FA x4(a[3],b[3],c2,s[3],c3);
  • 53.
    53 //incrementer circuit HA x5(s[2],c1,sum[0],c4); HAx6(s[3],c4,sum[1],c5); HA x7(c3,c5,sum[2],co); endmodule //full adder module module FA(a,b,cin,s,co); input a,b,cin; output s,co; wire d,e,f; xor (s,a,b,c); and (d,a,b); and (e,b,c); and (f,a,c); or (co,d,e,f); endmodule //half adder module module HA(a,b,c,s); input a,b; output s,c; xor(s,a,b); and (c,a,b); endmodule Verilog Code for 8-bit Carry Increment Adder module cia8(a,b,cin,s,co); input [7:0]a; input [7:0]b; input cin; output [7:0]s; output co; wire sum4,sum5,sum6,sum7,c[0],c[1],c[2]; //overall circuit desciption RCA x1(a[3:0],b[3:0],cin,s[3:0],1); RCA x2(a[7:4],b[7:4],0,sum[7:4],0); //incrementor circuit HA x3(sum[4],1,s[4],c[0]); HA x4(sum[5],c[0],s[5],c[1]);
  • 54.
    54 HA x5(sum[6],c[1],s[6],c[2]); HA x6(sum[7],c[2],s[7],co); endmodule //RCA 4bit module module RCA (A,B,Ci,So,Co); //outputs output [3:0] So ; output Co ; //inputs input [3:0] A ; input [3:0] B ; input Ci ; //internal wiring wire c1,c2,c3,c4; wire g0,g1,g2,g3; wire p0,p1,p2,p3; //g = A * B assign g0=A[0]&B[0]; assign g1=A[1]&B[1]; assign g2=A[2]&B[2]; assign g3=A[3]&B[3]; //p = A + B assign p0=A[0]|B[0]; assign p1=A[1]|B[1]; assign p2=A[2]|B[2]; assign p3=A[3]|B[3]; //c = g + (p * Ci)... assign c1=g0|(p0&Ci); assign c2=g1|(p1&g0)|(p1&p0&Ci); assign c3=g2|(p2&g1)|(p2&p1&g0)|(p2&p1&p0&Ci); assign c4=g3|(p3&g2)|(p3&p2&g1)|(p3&p2&p1&g0)|(p3&p2&p1&p0&Ci); assign Co=c4; //S = g XOR p XOR C assign So[0]=g0^p0^Ci; assign So[1]=g1^p1^c1; assign So[2]=g2^p2^c2; assign So[3]=g3^p3^c3; endmodule //HA module module HA(a,b,s,c);
  • 55.
    55 input a,b; output s,c; xor(s,a,b); and(c,a,b); endmodule Verilog Code for 16-bit Carry Increment Adder module cia16bit(a,b,cin,s,co); input [15:0]a; input [15:0]b; input cin; output [16:0]s; output co; wire [7:0]c; wire [16:8]sum; wire carry,carry1; //overall circuit desciption ripplemod x1(a[7:0],b[7:0],cin,s[7:0],carry); ripplemod x2(a[15:8],b[15:8],0,sum[16:8],carry1); //incrementor circuit HA x3(sum[8],carry,s[8],c[0]); HA x4(sum[9],c[0],s[9],c[1]); HA x5(sum[10],c[1],s[10],c[2]); HA x6(sum[11],c[2],s[11],c[3]); HA x7(sum[12],c[3],s[12],c[4]); HA x8(sum[13],c[4],s[13],c[5]); HA x9(sum[14],c[5],s[14],c[6]); HA x10(sum[15],c[6],s[15],c[7]); HA x11(sum[16],carry1,s[16],co); endmodule //RCA 8bit module module ripplemod(a, b, cin, sum, cout); input [07:0] a; input [07:0] b; input cin; output [7:0]sum; output cout; wire[6:0] c; fulladd a1(a[0],b[0],cin,sum[0],c[0]);
  • 56.
    56 fulladd a2(a[1],b[1],c[0],sum[1],c[1]); fulladd a3(a[2],b[2],c[1],sum[2],c[2]); fulladda4(a[3],b[3],c[2],sum[3],c[3]); fulladd a5(a[4],b[4],c[3],sum[4],c[4]); fulladd a6(a[5],b[5],c[4],sum[5],c[5]); fulladd a7(a[6],b[6],c[5],sum[6],c[6]); fulladd a8(a[7],b[7],c[6],sum[7],cout); endmodule //full addder module module fulladd(a, b, cin, sum, cout); input a; input b; input cin; output sum; output cout; assign sum=(a^b^cin); assign cout=((a&b)|(b&cin)|(a&cin)); endmodule //HA module module HA(a,b,s,c); input a,b; output s,c; xor x12(s,a,b); and x13(c,a,b); endmodule Appendix:F Verilog Code for 4-bit Carry Skip Adder module carryskipadder(A, B, X, CIN, COUT); input [3:0]A, B; input CIN; output [3:0]X; output COUT; reg [3:0]X; reg [2:0]base; reg [2:0]ifzero; reg [2:0]ifone;
  • 57.
    57 reg COUT; always @(Aor B or CIN) begin base = A[1:0] + B[1:0] + {1'b0, CIN}; ifzero = A[3:2] + B[3:2]; ifone = A[3:2] + B[3:2] + 2'b01; if(base[2]) begin X = {ifone[1:0], base[1:0]}; COUT = ifone[2]; end else begin X = {ifzero[1:0], base[1:0]}; COUT = ifzero[2]; end end endmodule Verilog Code for 8-bit Carry Skip Adder Verilog code for 8 bit csa : module fulladd_p(a,b,carryin,sum,carryout,p); input a, b, carryin; /* add these bits*/ output sum, carryout, p; /* results including propagate */ assign {carryout, sum} = a + b + carryin; /* compute the sum and carry */ assign p = a | b; endmodule module carryskip(a,b,carryin,sum,carryout); input [7:0] a, b; /* add these bits */ input carryin; /* carry in*/ output [7:0] sum; /* result */ output carryout; wire [8:1] carry; /* transfers the carry between bits */ wire [7:0] p; /* propagate for each bit */ wire cs4; /* final carry for first group */ fulladd_p a0(a[0],b[0],carryin,sum[0],carry[1],p[0]); fulladd_p a1(a[1],b[1],carry[1],sum[1],carry[2],p[1]); fulladd_p a2(a[2],b[2],carry[2],sum[2],carry[3],p[2]);
  • 58.
    58 fulladd_p a3(a[3],b[3],carry[3],sum[3],carry[4],p[3]); assign cs4= carry[4] | (p[0] & p[1] & p[2] & p[3] & carryin); fulladd_p a4(a[4],b[4],cs4, sum[4],carry[5],p[4]); fulladd_p a5(a[5],b[5],cs4, sum[5],carry[6],p[5]); fulladd_p a6(a[6],b[6],cs4, sum[6],carry[7],p[6]); fulladd_p a7(a[7],b[7],cs4, sum[7],carry[8],p[7]); assign carryout = carry[8] | (p[4] & p[5] & p[6] & p[7] & cs4); endmodule Verilog Code for 16-bit Carry Skip Adder module fulladd_p(a,b,carryin,sum,carryout,p); input a, b, carryin; /* add these bits*/ output sum, carryout, p; /* results including propagate */ assign {carryout, sum} = a + b + carryin; /* compute the sum and carry */ assign p = a | b; endmodule module carryskip(a,b,carryin,sum,carryout); input [15:0] a, b; /* add these bits */ input carryin; /* carry in*/ output [15:0] sum; /* result */ output carryout; wire [16:1] carry; /* transfers the carry between bits */ wire [15:0] p; /* propagate for each bit */ wire cs4,cs5,cs6,cs7; /* final carry for first group */ fulladd_p a0(a[0],b[0],carryin,sum[0],carry[1],p[0]); fulladd_p a1(a[1],b[1],carry[1],sum[1],carry[2],p[1]); fulladd_p a2(a[2],b[2],carry[2],sum[2],carry[3],p[2]); fulladd_p a3(a[3],b[3],carry[3],sum[3],carry[4],p[3]); assign cs4 = carry[4] | (p[0] & p[1] & p[2] & p[3] & carryin); fulladd_p a4(a[4],b[4],cs4, sum[4],carry[5],p[4]); fulladd_p a5(a[5],b[5],cs4, sum[5],carry[6],p[5]); fulladd_p a6(a[6],b[6],cs4, sum[6],carry[7],p[6]); fulladd_p a7(a[7],b[7],cs4, sum[7],carry[8],p[7]); assign cs5= carry[8] | (p[4] & p[5] & p[6] & p[7] & cs4); fulladd_p a8(a[8],b[8],cs5, sum[8],carry[9],p[8]);
  • 59.
    59 fulladd_p a9(a[9],b[9],cs5, sum[9],carry[10],p[9]); fulladd_pa10(a[10],b[10],cs5, sum[10],carry[11],p[10]); fulladd_p a11(a[11],b[11],cs5, sum[11],carry[12],p[11]); assign cs6= carry[12] | (p[8] & p[9] & p[10] & p[11] & cs5); fulladd_p a12(a[12],b[12],cs6, sum[12],carry[13],p[12]); fulladd_p a13(a[13],b[13],cs6, sum[13],carry[14],p[13]); fulladd_p a14(a[14],b[14],cs6, sum[14],carry[15],p[14]); fulladd_p a15(a[15],b[15],cs6, sum[15],carry[16],p[15]); assign carryout= carry[16] | (p[12] & p[13] & p[14] & p[15] & cs6); endmodule
