Project Estimation Techniques
Designed and Developed by https://www.pmbypm.com
1
Agenda
• Estimation Techniques
• Reserve Analysis
Designed and Developed by https://www.pmbypm.com
2

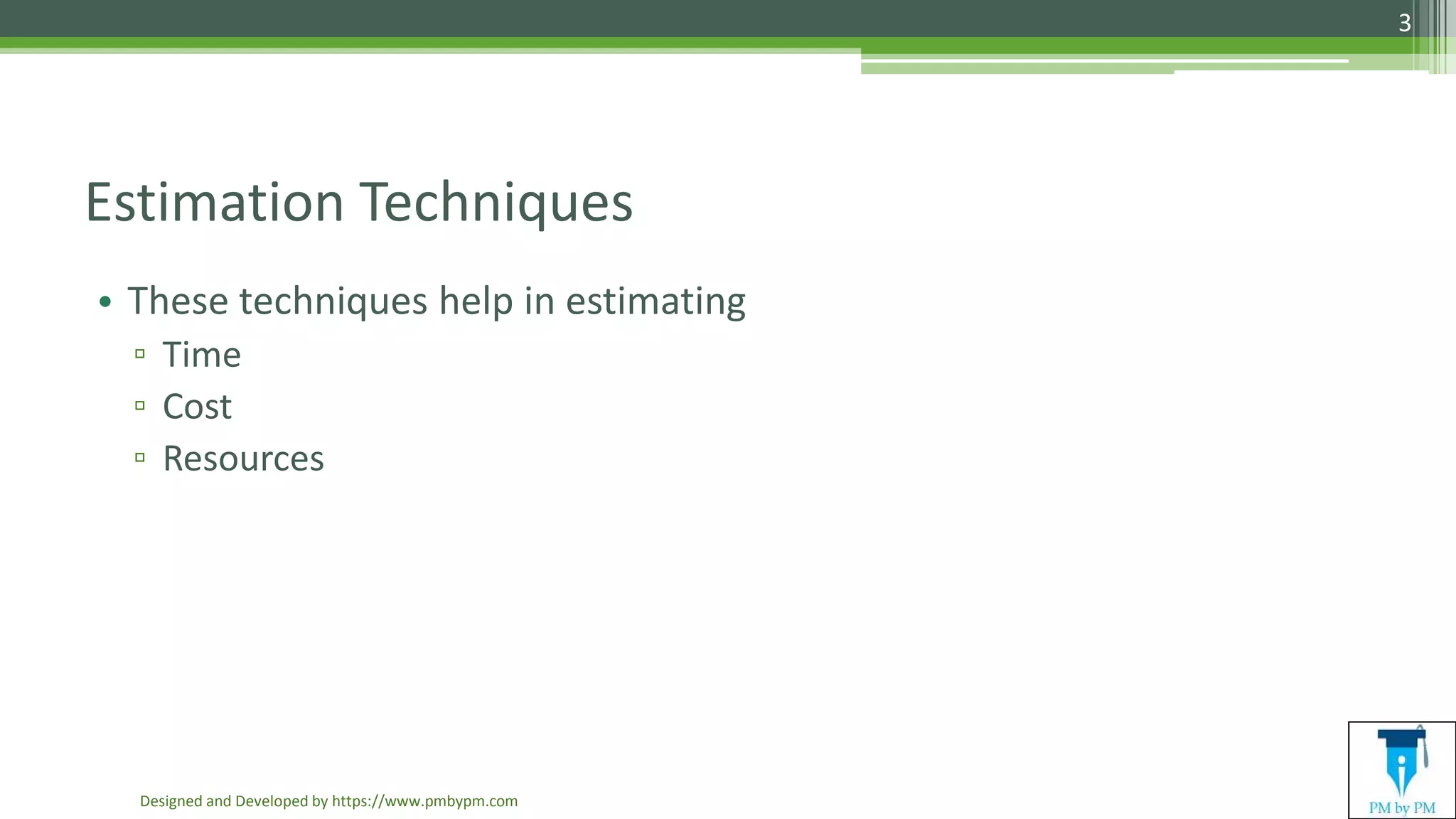

Estimation Techniques
• These techniques help in estimating
▫ Time
▫ Cost
▫ Resources
Designed and Developed by https://www.pmbypm.com
3

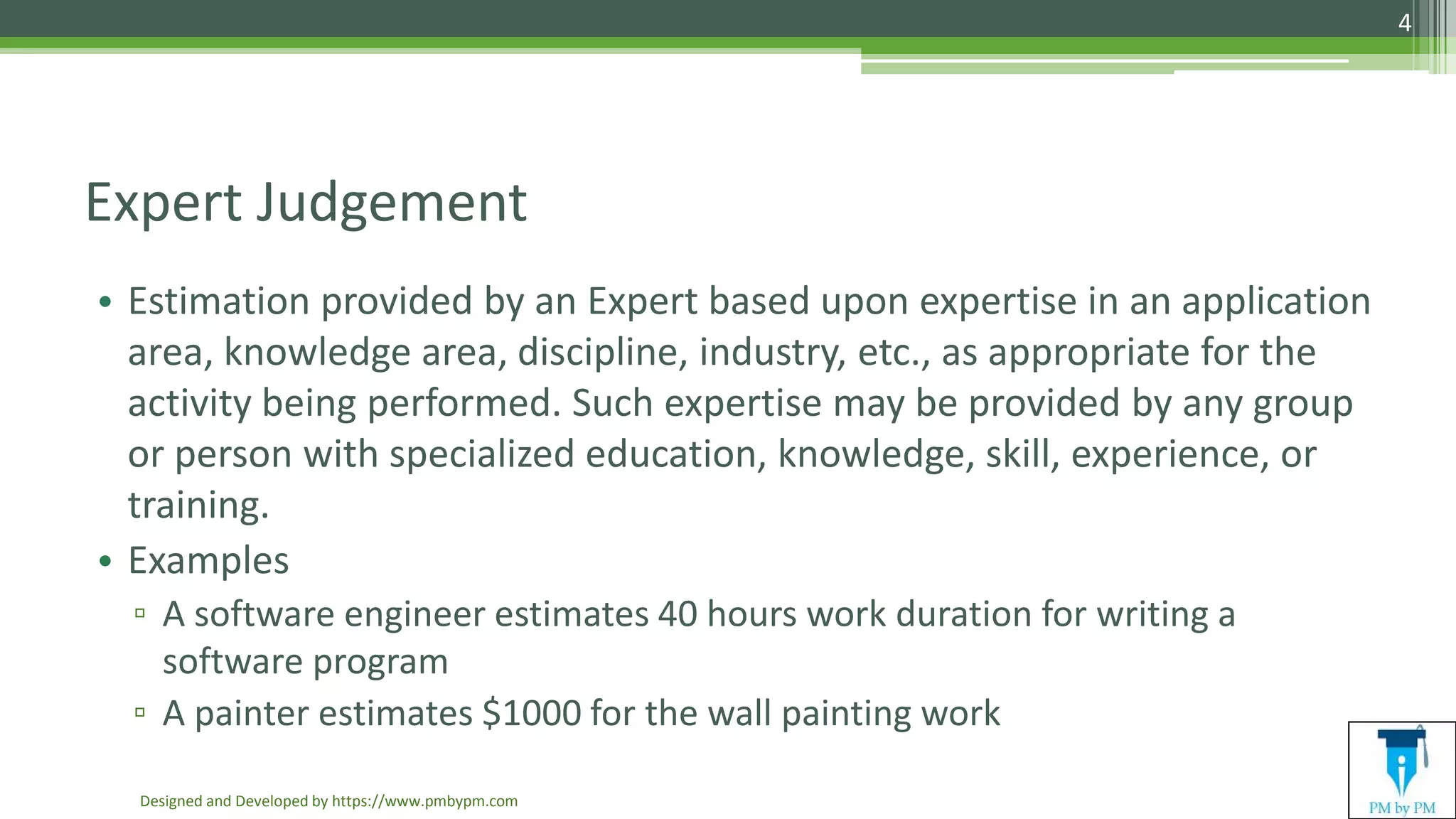

Expert Judgement
• Estimation provided by an Expert based upon expertise in an application
area, knowledge area, discipline, industry, etc., as appropriate for the
activity being performed. Such expertise may be provided by any group
or person with specialized education, knowledge, skill, experience, or
training.
• Examples
▫ A software engineer estimates 40 hours work duration for writing a
software program
▫ A painter estimates $1000 for the wall painting work
Designed and Developed by https://www.pmbypm.com
4

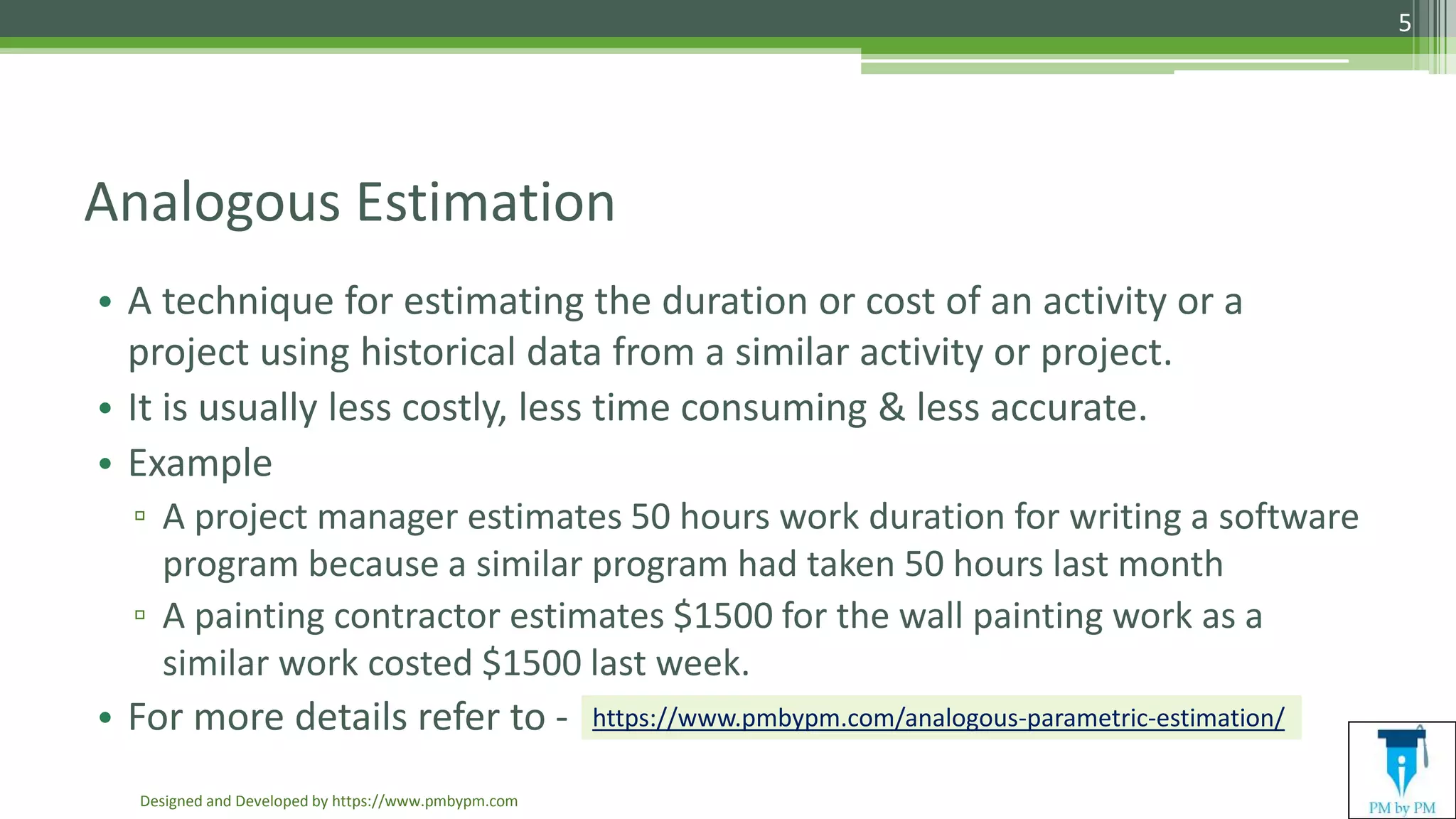

Analogous Estimation
• A technique for estimating the duration or cost of an activity or a
project using historical data from a similar activity or project.
• It is usually less costly, less time consuming & less accurate.
• Example
▫ A project manager estimates 50 hours work duration for writing a software
program because a similar program had taken 50 hours last month
▫ A painting contractor estimates $1500 for the wall painting work as a
similar work costed $1500 last week.
• For more details refer to -
Designed and Developed by https://www.pmbypm.com
5
https://www.pmbypm.com/analogous-parametric-estimation/

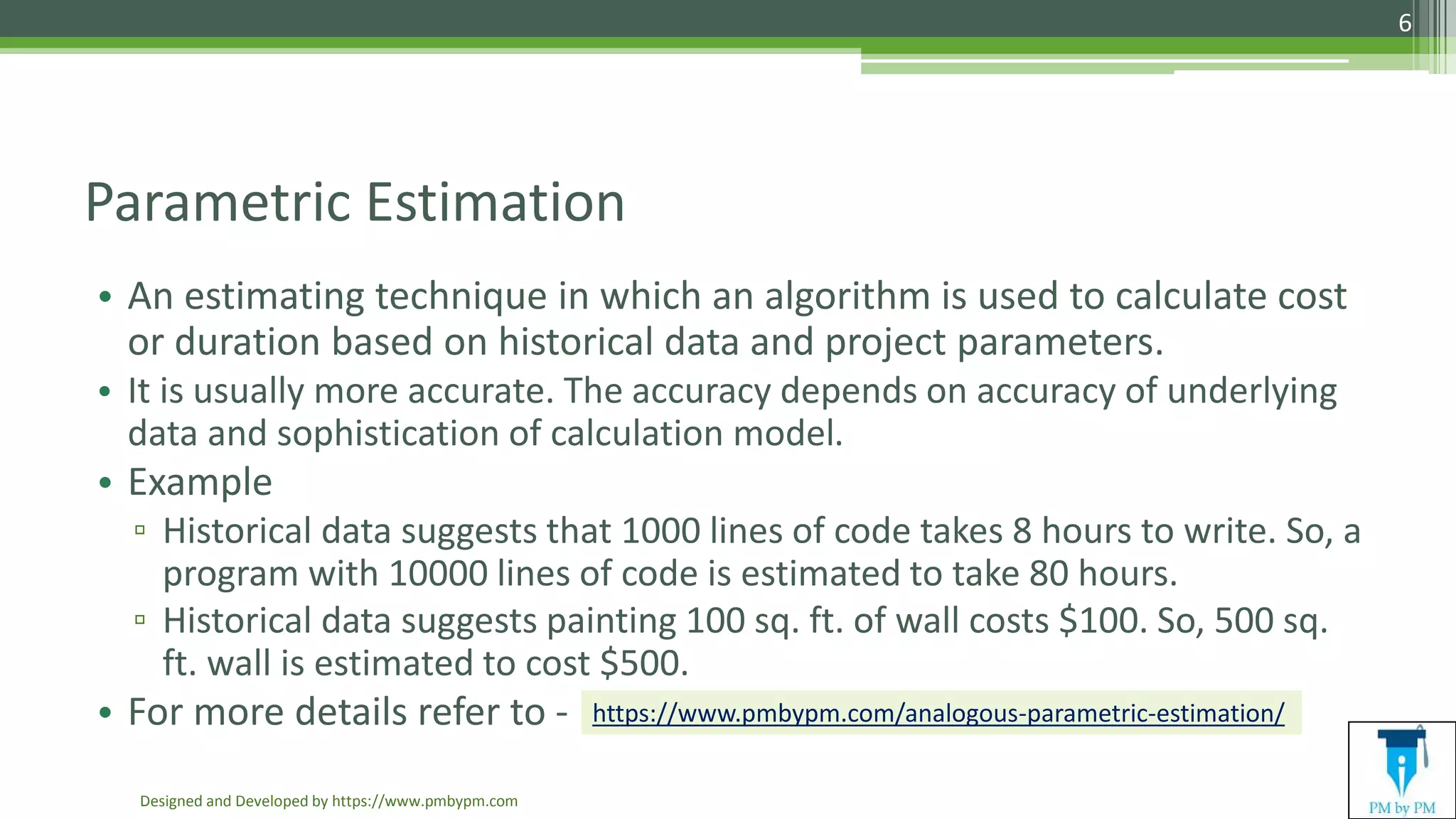

Parametric Estimation
• An estimating technique in which an algorithm is used to calculate cost
or duration based on historical data and project parameters.
• It is usually more accurate. The accuracy depends on accuracy of underlying
data and sophistication of calculation model.
• Example
▫ Historical data suggests that 1000 lines of code takes 8 hours to write. So, a
program with 10000 lines of code is estimated to take 80 hours.
▫ Historical data suggests painting 100 sq. ft. of wall costs $100. So, 500 sq.
ft. wall is estimated to cost $500.
• For more details refer to -
Designed and Developed by https://www.pmbypm.com
6
https://www.pmbypm.com/analogous-parametric-estimation/

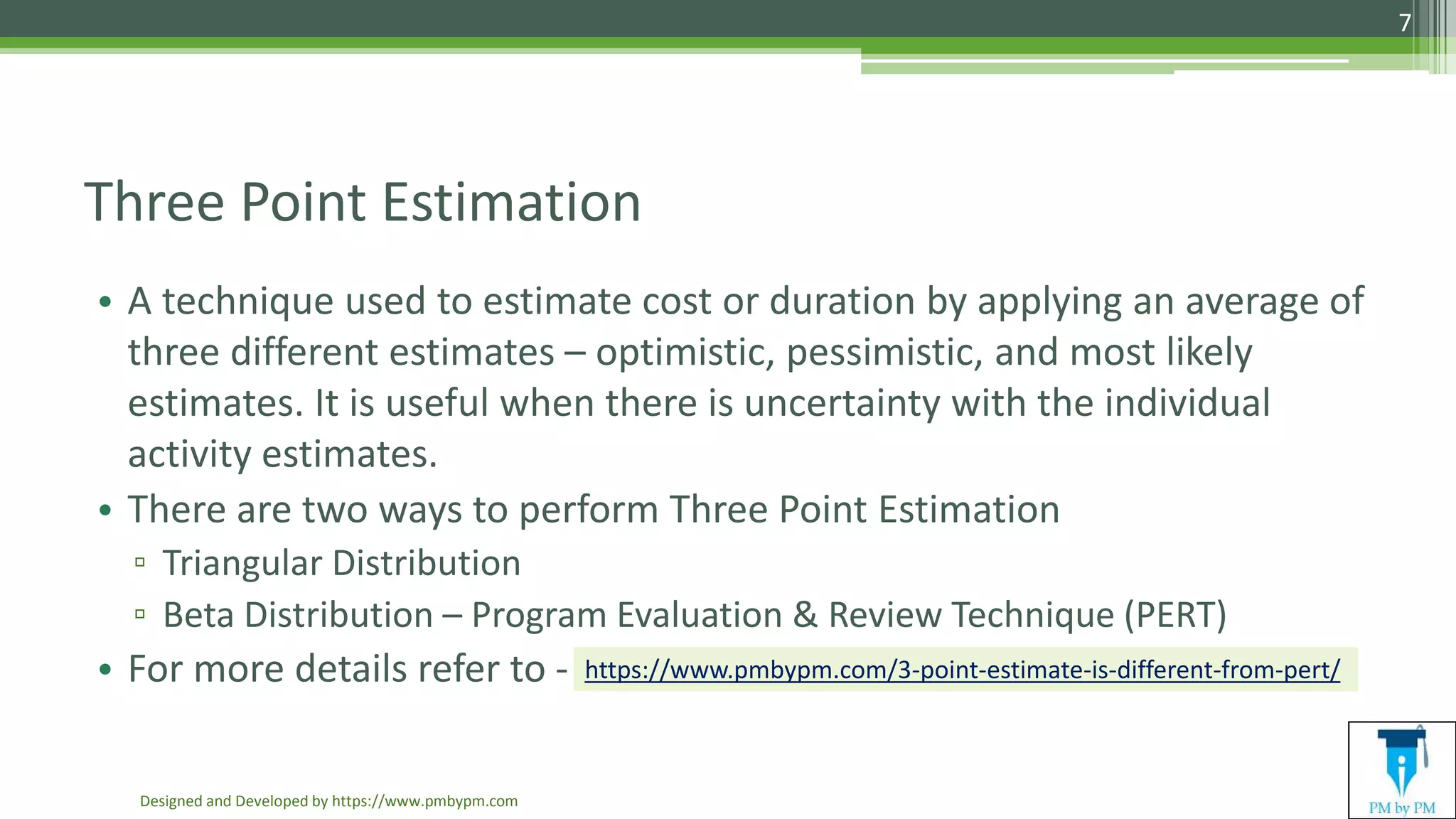

Three Point Estimation
• A technique used to estimate cost or duration by applying an average of
three different estimates – optimistic, pessimistic, and most likely
estimates. It is useful when there is uncertainty with the individual
activity estimates.
• There are two ways to perform Three Point Estimation
▫ Triangular Distribution
▫ Beta Distribution – Program Evaluation & Review Technique (PERT)
• For more details refer to -
Designed and Developed by https://www.pmbypm.com
7
https://www.pmbypm.com/3-point-estimate-is-different-from-pert/

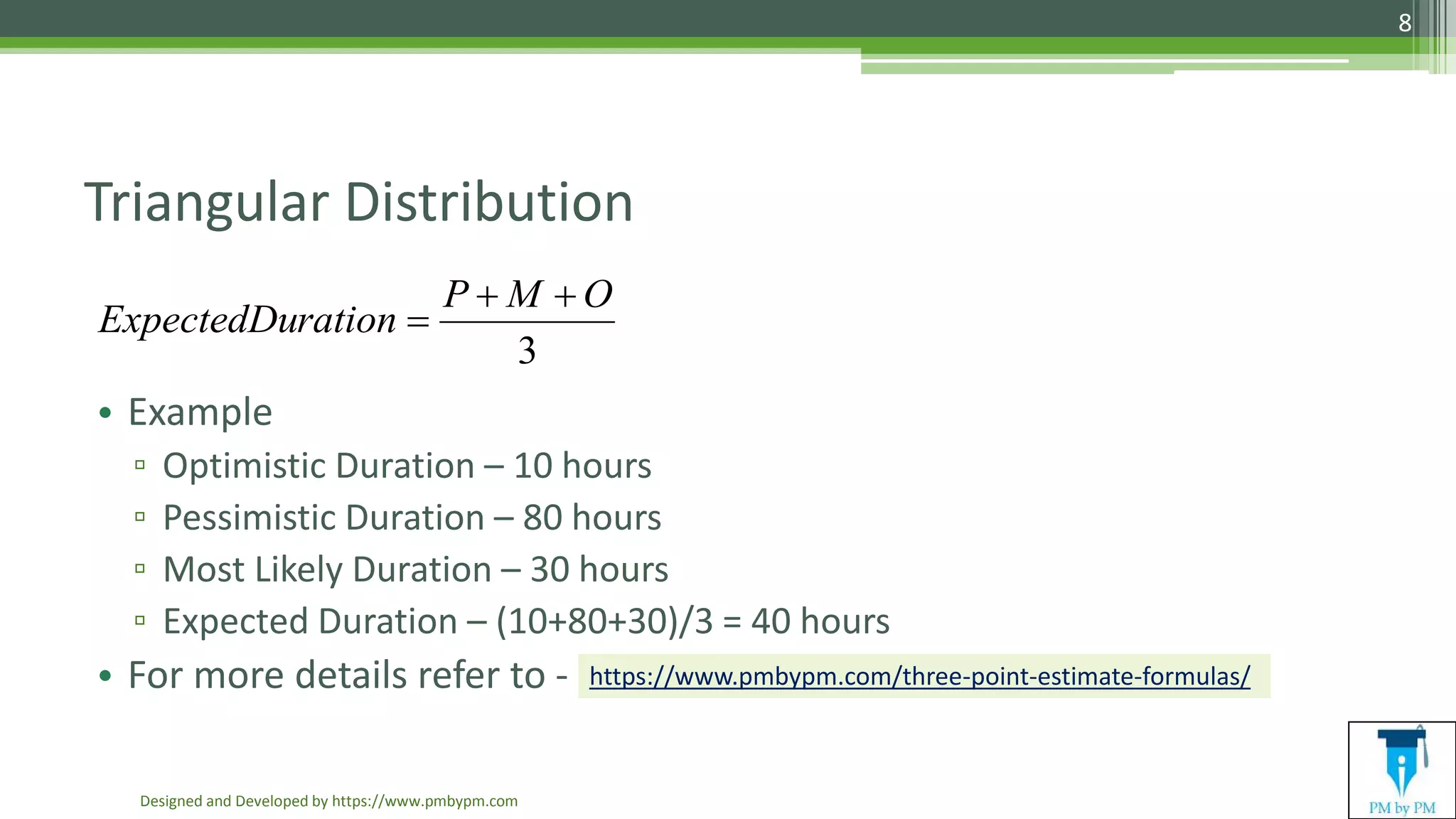

Triangular Distribution
• Example
▫ Optimistic Duration – 10 hours
▫ Pessimistic Duration – 80 hours
▫ Most Likely Duration – 30 hours
▫ Expected Duration – (10+80+30)/3 = 40 hours
• For more details refer to -
Designed and Developed by https://www.pmbypm.com
8
3
OMP
rationExpectedDu


https://www.pmbypm.com/three-point-estimate-formulas/

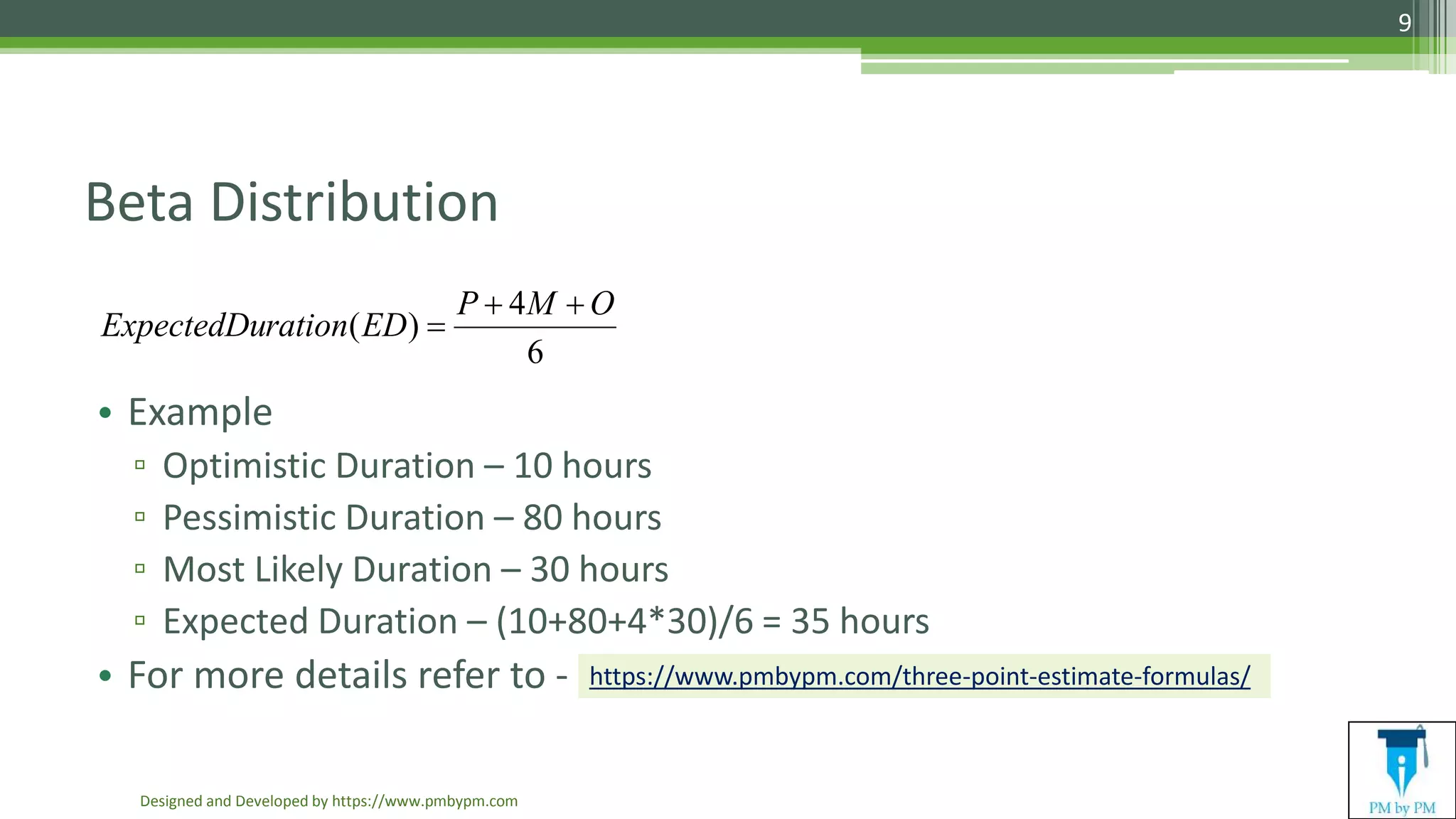

Beta Distribution
• Example
▫ Optimistic Duration – 10 hours
▫ Pessimistic Duration – 80 hours
▫ Most Likely Duration – 30 hours
▫ Expected Duration – (10+80+4*30)/6 = 35 hours
• For more details refer to -
Designed and Developed by https://www.pmbypm.com
9
https://www.pmbypm.com/three-point-estimate-formulas/
6
4
)(
OMP
EDrationExpectedDu



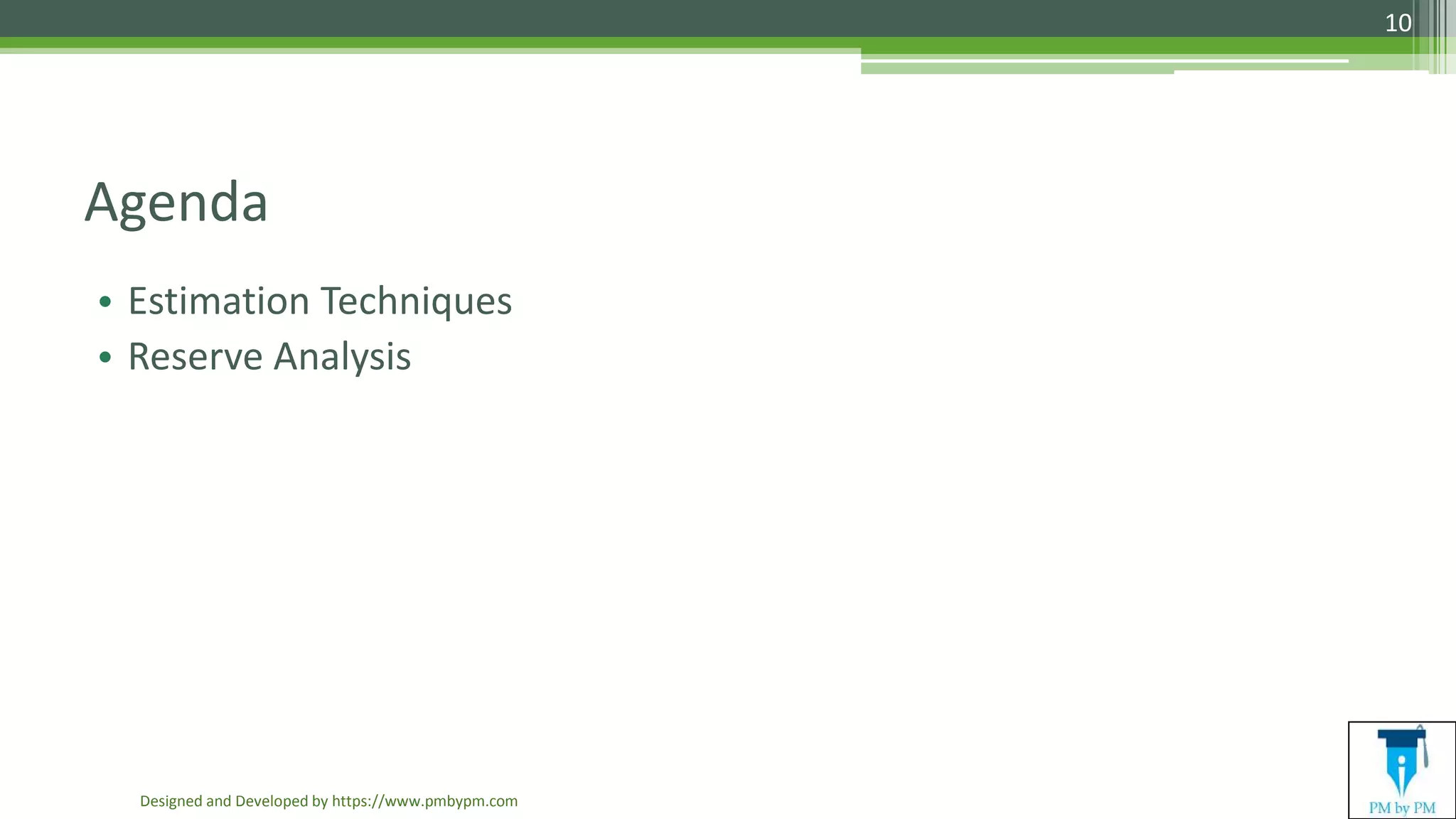

Agenda
• Estimation Techniques
• Reserve Analysis
Designed and Developed by https://www.pmbypm.com
10

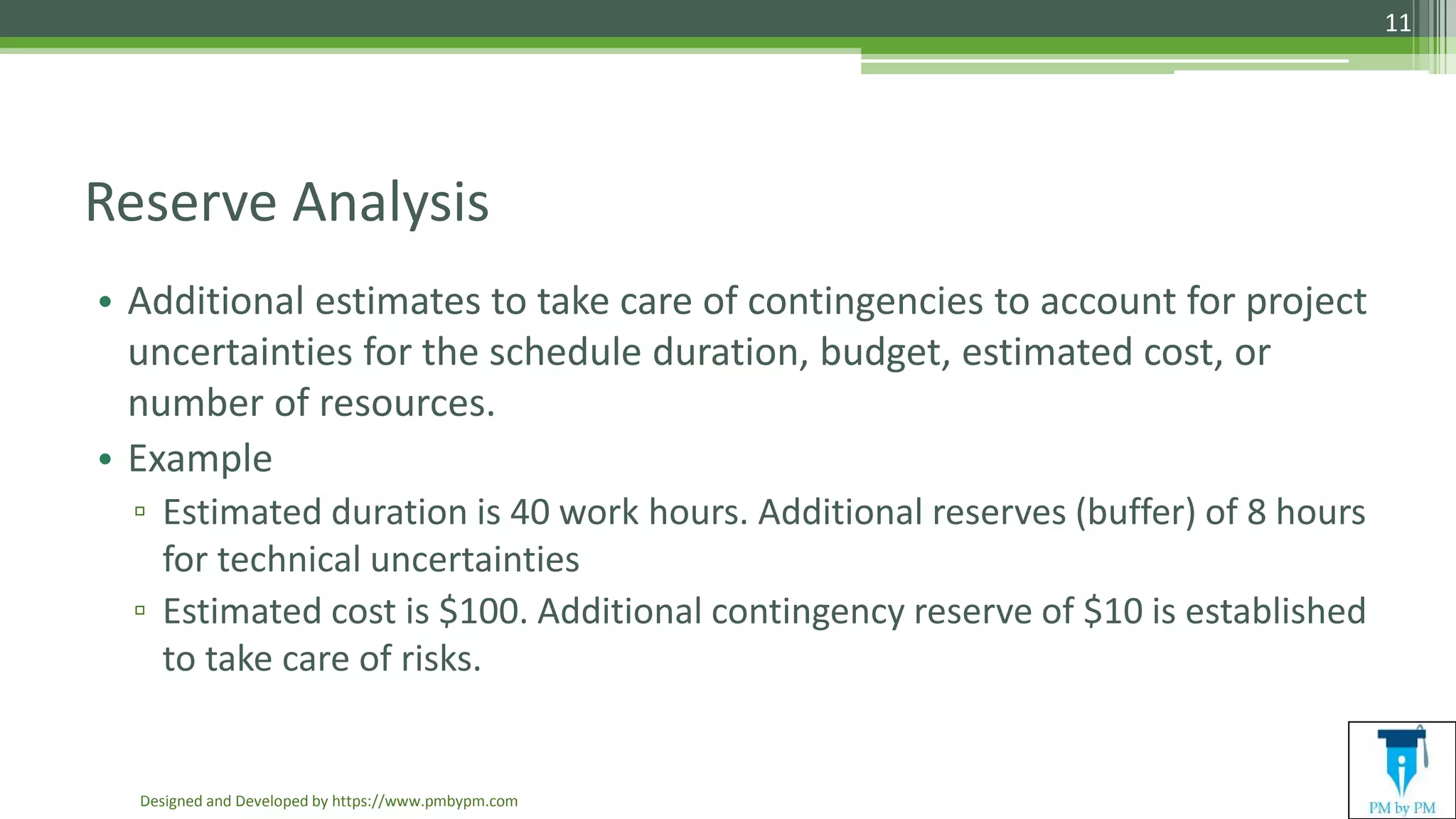

Reserve Analysis
• Additional estimates to take care of contingencies to account for project
uncertainties for the schedule duration, budget, estimated cost, or
number of resources.
• Example
▫ Estimated duration is 40 work hours. Additional reserves (buffer) of 8 hours
for technical uncertainties
▫ Estimated cost is $100. Additional contingency reserve of $10 is established
to take care of risks.
Designed and Developed by https://www.pmbypm.com
11
YOUR OPINION IS IMPORTANT TO US
FOR ANY QUESTIONS OR SUGGESTIONS CONTACT US @
https://www.pmbypm.com/contact-praveen-malik/
Designed and Developed by https://www.pmbypm.com
12

4 Project Estimation Techniques That Can Make You Super Successful

  • 1.
    Project Estimation Techniques Designedand Developed by https://www.pmbypm.com 1
  • 2.
    Agenda • Estimation Techniques •Reserve Analysis Designed and Developed by https://www.pmbypm.com 2
  • 3.
    Estimation Techniques • Thesetechniques help in estimating ▫ Time ▫ Cost ▫ Resources Designed and Developed by https://www.pmbypm.com 3
  • 4.
    Expert Judgement • Estimationprovided by an Expert based upon expertise in an application area, knowledge area, discipline, industry, etc., as appropriate for the activity being performed. Such expertise may be provided by any group or person with specialized education, knowledge, skill, experience, or training. • Examples ▫ A software engineer estimates 40 hours work duration for writing a software program ▫ A painter estimates $1000 for the wall painting work Designed and Developed by https://www.pmbypm.com 4
  • 5.
    Analogous Estimation • Atechnique for estimating the duration or cost of an activity or a project using historical data from a similar activity or project. • It is usually less costly, less time consuming & less accurate. • Example ▫ A project manager estimates 50 hours work duration for writing a software program because a similar program had taken 50 hours last month ▫ A painting contractor estimates $1500 for the wall painting work as a similar work costed $1500 last week. • For more details refer to - Designed and Developed by https://www.pmbypm.com 5 https://www.pmbypm.com/analogous-parametric-estimation/
  • 6.
    Parametric Estimation • Anestimating technique in which an algorithm is used to calculate cost or duration based on historical data and project parameters. • It is usually more accurate. The accuracy depends on accuracy of underlying data and sophistication of calculation model. • Example ▫ Historical data suggests that 1000 lines of code takes 8 hours to write. So, a program with 10000 lines of code is estimated to take 80 hours. ▫ Historical data suggests painting 100 sq. ft. of wall costs $100. So, 500 sq. ft. wall is estimated to cost $500. • For more details refer to - Designed and Developed by https://www.pmbypm.com 6 https://www.pmbypm.com/analogous-parametric-estimation/
  • 7.
    Three Point Estimation •A technique used to estimate cost or duration by applying an average of three different estimates – optimistic, pessimistic, and most likely estimates. It is useful when there is uncertainty with the individual activity estimates. • There are two ways to perform Three Point Estimation ▫ Triangular Distribution ▫ Beta Distribution – Program Evaluation & Review Technique (PERT) • For more details refer to - Designed and Developed by https://www.pmbypm.com 7 https://www.pmbypm.com/3-point-estimate-is-different-from-pert/
  • 8.
    Triangular Distribution • Example ▫Optimistic Duration – 10 hours ▫ Pessimistic Duration – 80 hours ▫ Most Likely Duration – 30 hours ▫ Expected Duration – (10+80+30)/3 = 40 hours • For more details refer to - Designed and Developed by https://www.pmbypm.com 8 3 OMP rationExpectedDu   https://www.pmbypm.com/three-point-estimate-formulas/
  • 9.
    Beta Distribution • Example ▫Optimistic Duration – 10 hours ▫ Pessimistic Duration – 80 hours ▫ Most Likely Duration – 30 hours ▫ Expected Duration – (10+80+4*30)/6 = 35 hours • For more details refer to - Designed and Developed by https://www.pmbypm.com 9 https://www.pmbypm.com/three-point-estimate-formulas/ 6 4 )( OMP EDrationExpectedDu  
  • 10.
    Agenda • Estimation Techniques •Reserve Analysis Designed and Developed by https://www.pmbypm.com 10
  • 11.
    Reserve Analysis • Additionalestimates to take care of contingencies to account for project uncertainties for the schedule duration, budget, estimated cost, or number of resources. • Example ▫ Estimated duration is 40 work hours. Additional reserves (buffer) of 8 hours for technical uncertainties ▫ Estimated cost is $100. Additional contingency reserve of $10 is established to take care of risks. Designed and Developed by https://www.pmbypm.com 11
  • 12.
    YOUR OPINION ISIMPORTANT TO US FOR ANY QUESTIONS OR SUGGESTIONS CONTACT US @ https://www.pmbypm.com/contact-praveen-malik/ Designed and Developed by https://www.pmbypm.com 12
