Putting the Project
Pieces Together
Estimating Training
Agenda Items
 Estimating Introduction
 Tools and Techniques Overview
 Rough-Order-of Magnitude (ROM)
Estimates
 Intermediate Estimates.
 Definitive Estimates.
 Help and References
 Additional Questions
Training Goals
 To understand Estimating Tools and
Techniques.
 To learn enough about the various
methods to use them effectively.
 To know where you can access more
information and supporting materials.
Estimating Introduction
• An approximate judgment or
opinion regarding the value,
amount, size, weight, timing,
etc.
• Based on documented
assumptions.
What is an estimate?
There are three primary estimating
techniques/types used by OIS.
OIS Primary Estimating
Types
 Rough-Order-of-Magnitude
(ROM) Estimates
( + - 50%)
 Intermediate Estimates
(+ or – 30%)
 Definitive Estimates
(+ or – 20%)
One technique or all may be used on a project.
What is it?
Rough-order-of-magnitude (ROM)
Approach
 An estimate obtained based on
very limited data.
 Consider to have + or – 50%
accuracy range.
 Usually the first estimate
developed or requested.
Supplies a range of values rather
than a single estimate.
Three Key Questions:
Rough-Order-of-Magnitude
--When is it
Appropriate?
 What is the Purpose of the estimate?
 How precise of an estimate do I NEED?
 How much time do I have?
--Both can be used with a limited
amount of information
ROM Estimating Techniques
 Parametric Estimating -uses a
statistical relationships
 Analogous Estimating - Using
actual or historical data, a
form of expert judgment.
What do I need to do a
Parametric Estimate?

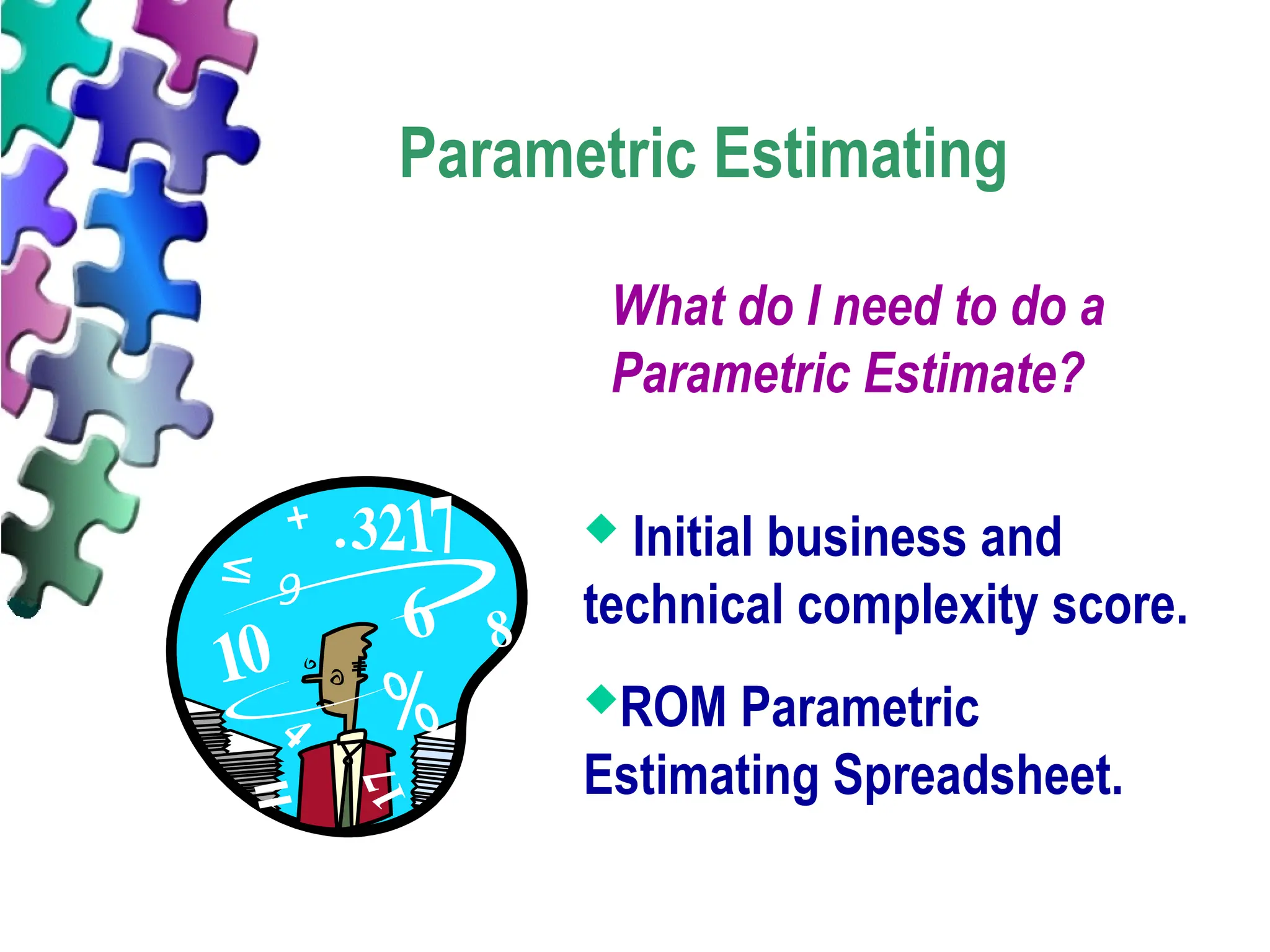

Parametric Estimating
 Initial business and
technical complexity score.
ROM Parametric
Estimating Spreadsheet.
ROM Parametric Estimating
Spreadsheet
How do I do a Parametric Estimate?
Parametric Estimating Steps
1. Complete the Business and
Technical Complexity Assessment
tool.
2. Enter results in ROM Parametric
Estimating Spreadsheet.
3. Make adjustments to estimate.
What do I need to do a
Analogous Estimate?
Analogous Estimating
 A recognized group of
technologists and
estimating experts.
 The product description
or Product Charter.
How do I do an Analogous Estimate?
Analogous Estimating Steps
1. Identify similar projects or activities.
2. Obtain actuals or historical data. How much did
the similar project or activities cost?
3. Re-evaluate and document the similarities and
differences.
4. Apply expert judgment and decide on estimate.
5. Document the estimate and estimating
assumptions.
Do NOT use Rough-Order-of
Magnitude…
When a precise or high level of confidence in
an estimate is needed!
What is it?
Intermediate Approach
 Used in support of a preliminary plan, a
partial plan, or a plan that does not require
precise estimating.
 Considered to be within “+ or – 30%”
accuracy.
 Often developed to support
the project plan in the early
phases of the project.
Intermediate—When should
I use it?
 What is the purpose of the estimate?
 When is an estimate needed for the project?
 What level of precision is needed?
 What is the estimate intended to cover?
Four Key Questions:
--Both require a
lower level of
detail about the
project to be
defined.
Intermediate Estimating
Techniques
 Parametric Estimating
 An estimating technique that uses a
statistical relationship between data
and other variables to calculate an
estimate. A Mathematical model.
(Percentage Based Estimating.)
 Delphi Estimating
 The Delphi estimating technique
uses a group of subject matter experts
who develop estimates independently,
discuss differences and assumptions,
and go through one or more revision
cycles, until a single estimates is
agreed upon.
What do I need to do an
Intermediate Parametric
Estimate?
Parametric Estimating
(Intermediate)
 Detailed Estimates of an
early phase.
Intermediate Parametric
Estimating Spreadsheet.

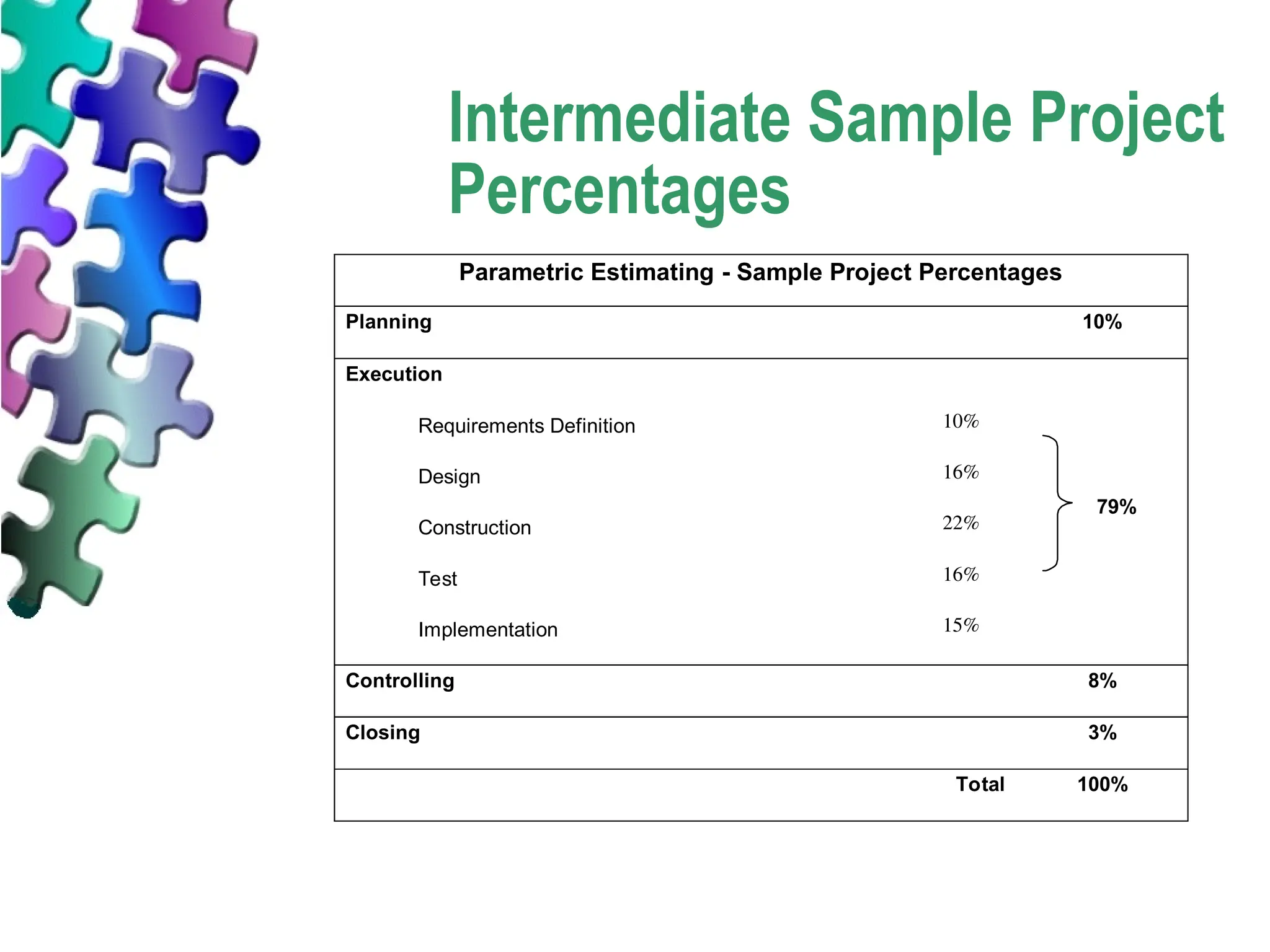

Intermediate Sample Project
Percentages
Parametric Estimating - Sample Project Percentages
Planning 10%
Execution
Requirements Definition 10%
Design 16%
Construction 22%
Test 16%
Implementation 15%
79%
Controlling 8%
Closing 3%
Total 100%
How do I do a Parametric Estimate?
Parametric Estimating Steps
1. Adjust the recommended work
effort percentages
2. Enter the total known dollar and
duration estimates for the early
sub-phase.
What do I need to do a
Delphi Estimate?
Delphi Estimating
 A Group of SMEs
 The product description
and Work Breakdown
Structure
Estimating Facilitator
How do I do a Delphi Estimate?
Delphi Estimating Steps
1. Gather written estimates from the experts for each item
in the WBS Poll group and write estimate on a flipchart
or whiteboard (no discussion).
2. If estimates are the same, go to next item estimated and
repeat this step.
3. Discuss differences and assumptions. Rethink if
necessary
4. Review/revise estimates.
5. Continue step 2-4 until consensus is reached.
Consensus
--Consensus means either each
estimator strongly agrees with the
estimate or can live with it.
--Consensus is not reached if an
estimator strongly disagrees with
the estimate.
What is it?
Definitive Approach
 Used to develop the precise
estimates needed to tactically
manage and complete a
project.
 Considered to have a
“+ or – 20%” accuracy.
 The most accurate estimate for the
amount of work and resources.
 The estimate the organization will
commit to for the project baseline.

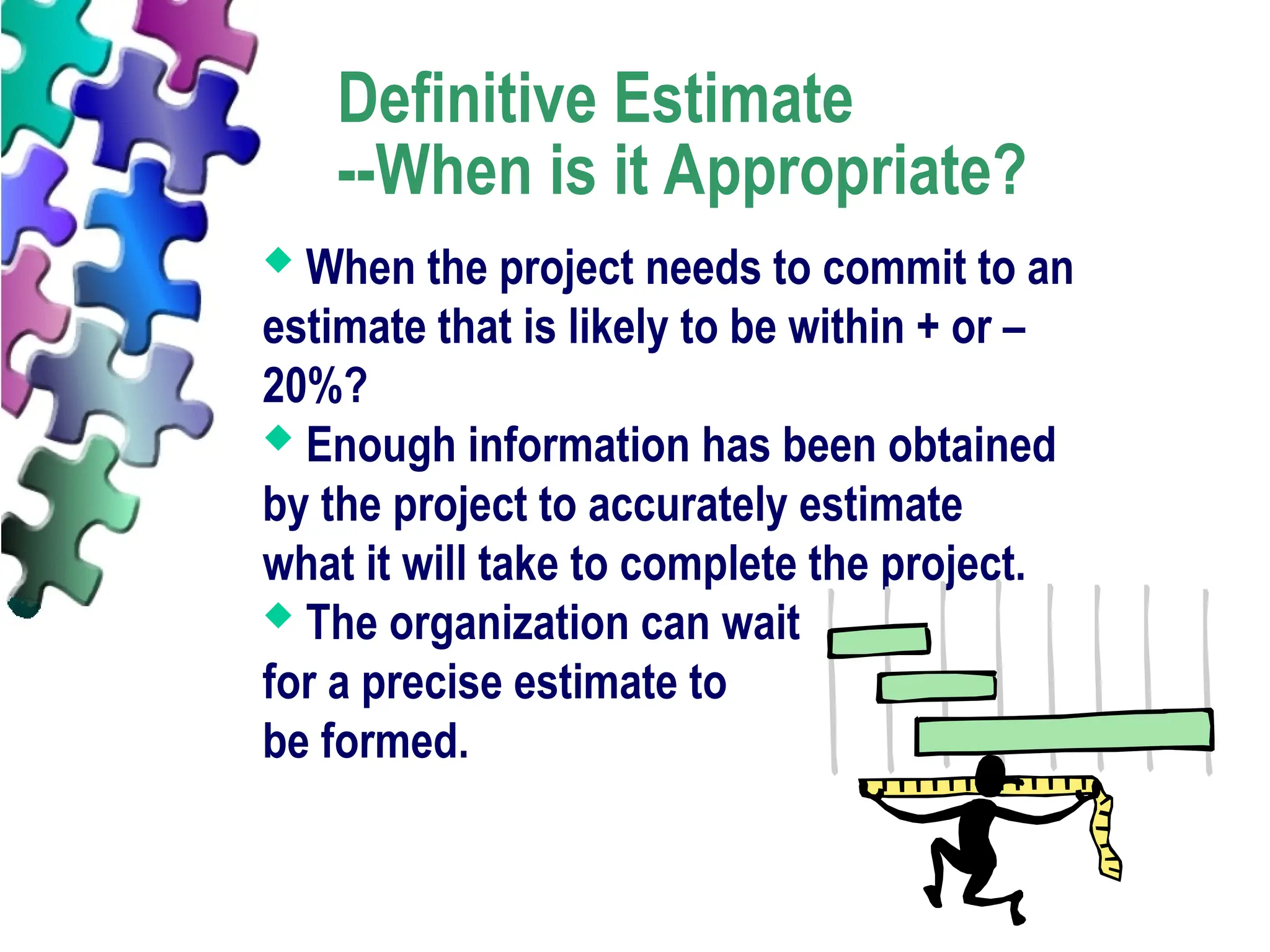

Definitive Estimate
--When is it Appropriate?
 When the project needs to commit to an
estimate that is likely to be within + or –
20%?
 Enough information has been obtained
by the project to accurately estimate
what it will take to complete the project.
 The organization can wait
for a precise estimate to
be formed.
--Variations on the
use of three
estimates, most
optimistic, most
likely and most
pessimistic to
determine a single
estimate.
Definitive Estimating
Techniques
 Forecasting
 Requires a strong historical base
 Triangulation
 Range
 PERT (Recommended
Approach)
What is a PERT Estimate?
PERT Estimating
Program Evaluation Review
Technique
• Uses optimistic, pessimistic, and
most likely estimates.
• Most likely estimate is weighted
more heavily
Other Facts
PERT Estimating
-- One single estimate is not always accurate and by using three
estimates, risk factors can be incorporated.
--Using identified risks to estimate:
Most pessimistic (many risk will occur) + most likely (weighted average
number of risks will occur) + most optimistic (few risks will occur)/6
= The Single, most accurate estimate.
Estimate = Pessimistic + (4 x Likely) + Optimistic / 6
Estimate = Pessimistic + (4 x Likely) + Optimistic / 6
What do I need to do a PERT?
PERT Estimating--
Prerequisites
 WBS
 PERT Analysis Formula
 Sources for estimates
What steps do I use?
PERT Estimating Steps
1. Ascertain the most optimistic, most
likely and most pessimistic estimates.
2. Use the PERT formula to calculate a
single estimate.
3. Apply the single estimate to each item
in the WBS.
Wrap It Up!

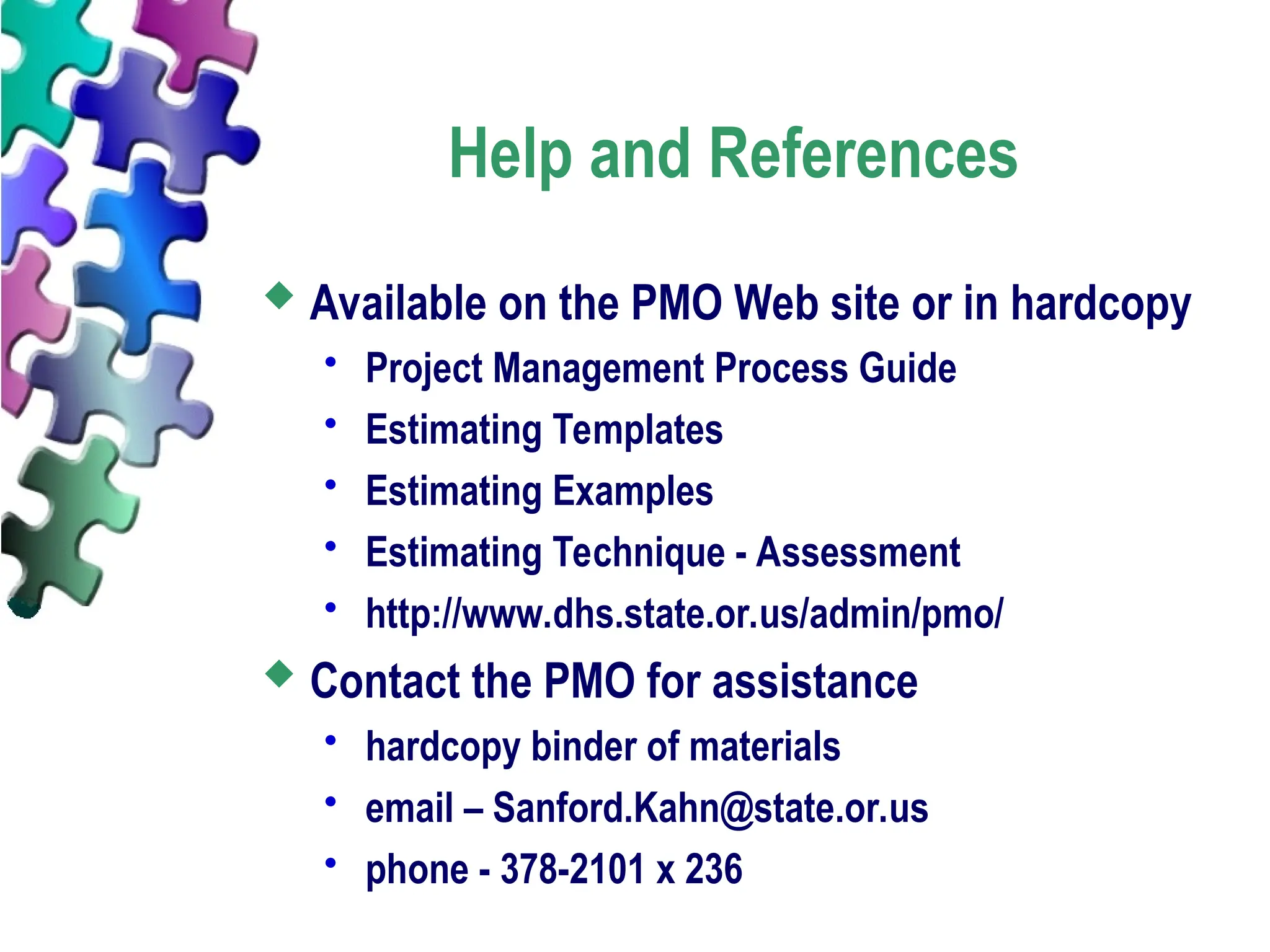

Help and References
 Available on the PMO Web site or in hardcopy
 Project Management Process Guide
 Estimating Templates
 Estimating Examples
 Estimating Technique - Assessment
 http://www.dhs.state.or.us/admin/pmo/
 Contact the PMO for assistance
 hardcopy binder of materials
 email – Sanford.Kahn@state.or.us
 phone - 378-2101 x 236
Additional Questions
Please take some time for
Class Evaluation!
