TOLL APPLICATION

Toll Application
Software Requirements Specification

Mentor
Mr.R.Jayaraj (Asst. Professor), Department of CSE
Members
Arun Prasath.S

-

090105107008

Jojy George

-

100405107005

Prabhu.E

-

100405107013

Vivek Andrew Sha -

090105107121

College - Hindusthan College of Engineering and Technology, Coimbatore – 641032
Department - Computer Science and Engineering
State - Tamil Nadu

Toll Application | Omnificence

Page 1
TOLL APPLICATION

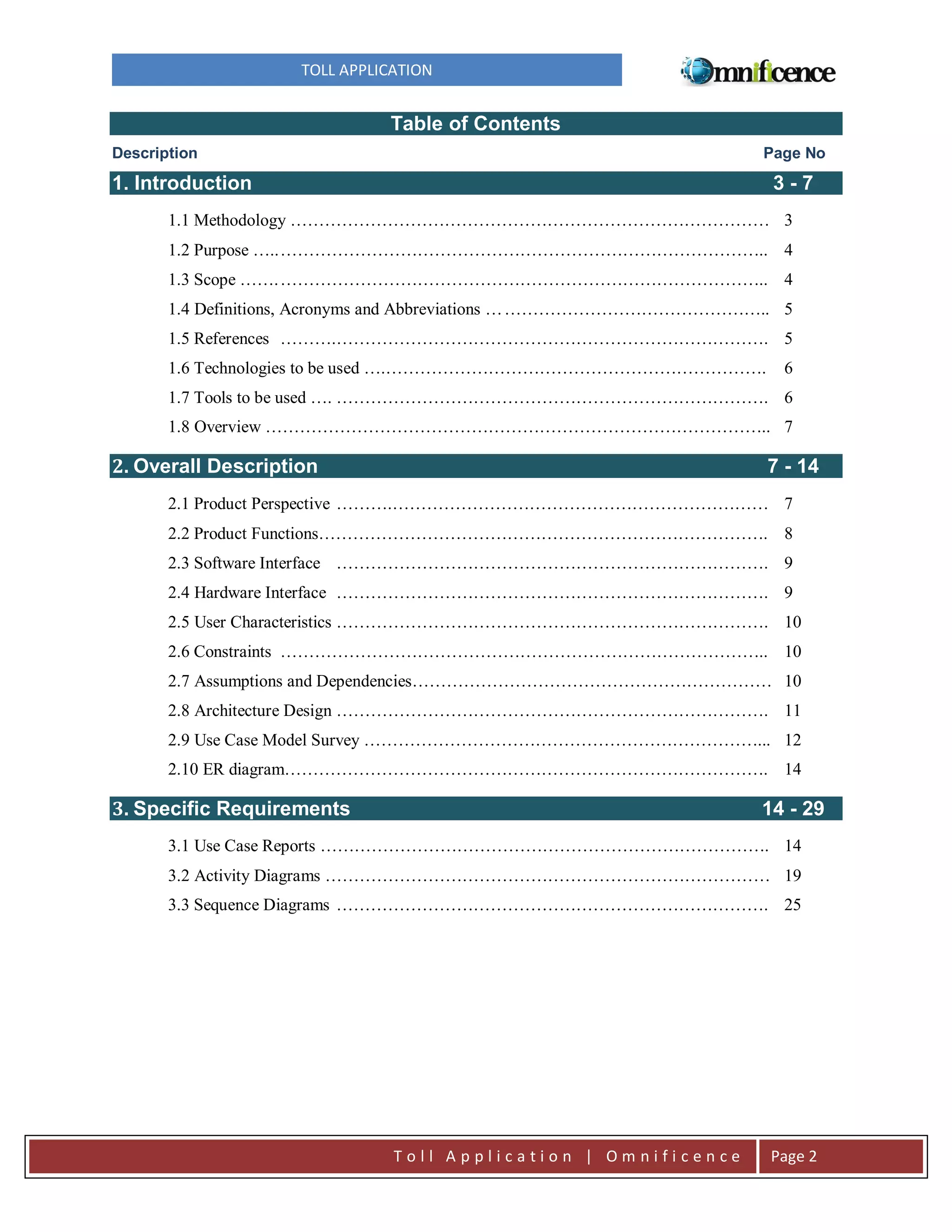

Table of Contents
Description

Page No

1. Introduction

3-7

1.1 Methodology ………………………………………………………………………… 3
1.2 Purpose ….. ………………………………………………………………………….. 4
1.3 Scope ……. ………………………………………………………………………….. 4
1.4 Definitions, Acronyms and Abbreviations … ……………………………………….. 5
1.5 References ……….…………………………………………………………………. 5
1.6 Technologies to be used ….………………………………………………………….

6

1.7 Tools to be used …. …………………………………………………………………. 6
1.8 Overview …………………………………………………………………………….. 7

2. Overall Description

7 - 14

2.1 Product Perspective ……….………………………………………………………… 7
2.2 Product Functions……………………………………………………………………. 8
2.3 Software Interface …………………………………………………………………. 9
2.4 Hardware Interface …………………………………………………………………. 9
2.5 User Characteristics …………………………………………………………………. 10
2.6 Constraints ………………………………………………………………………….. 10
2.7 Assumptions and Dependencies……………………………………………………… 10
2.8 Architecture Design …………………………………………………………………. 11
2.9 Use Case Model Survey ……………………………………………………………... 12
2.10 ER diagram…………………………………………………………………………. 14

3. Specific Requirements

14 - 29

3.1 Use Case Reports ……………………………………………………………………. 14
3.2 Activity Diagrams …………………………………………………………………… 19
3.3 Sequence Diagrams …………………………………………………………………. 25

Toll Application | Omnificence

Page 2
TOLL APPLICATION

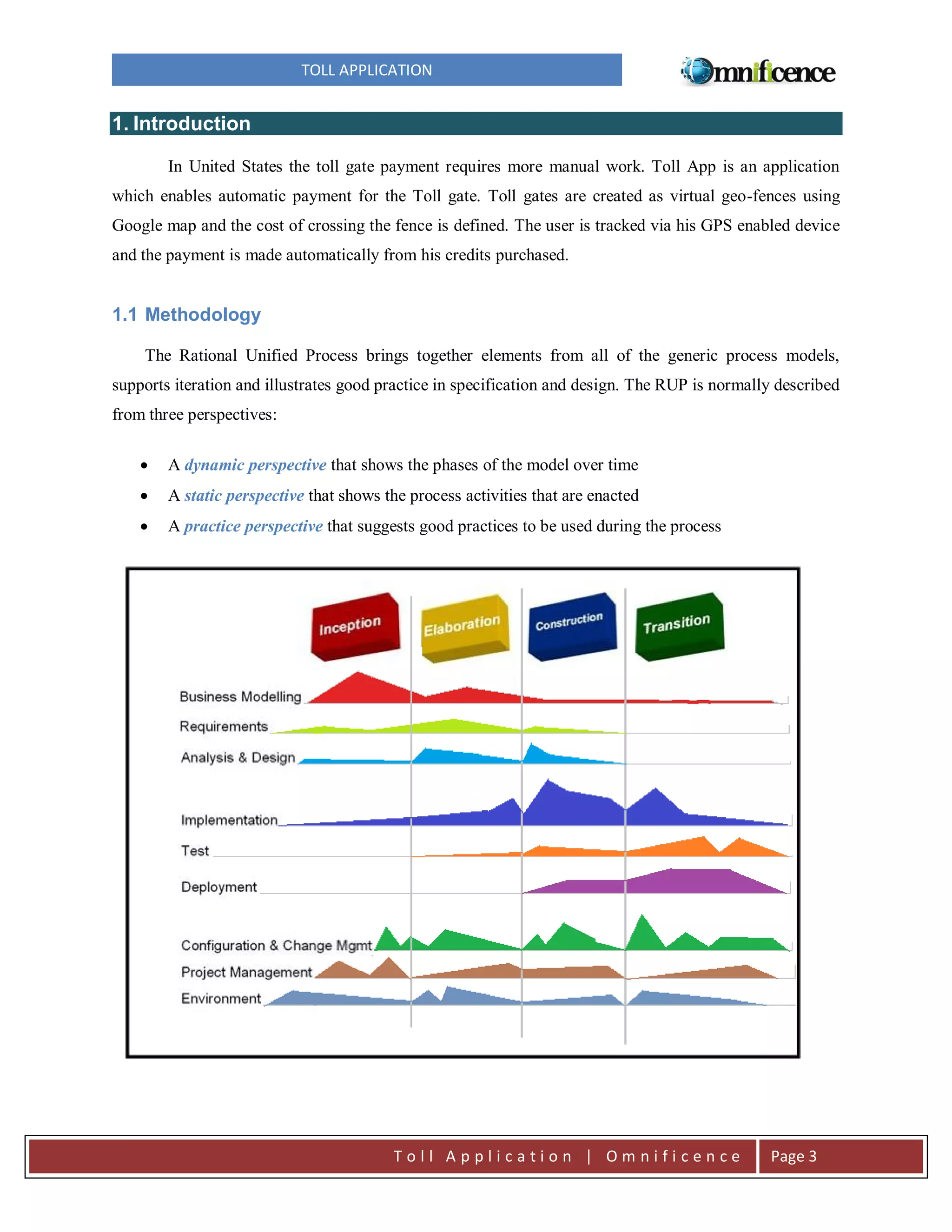

1. Introduction
In United States the toll gate payment requires more manual work. Toll App is an application
which enables automatic payment for the Toll gate. Toll gates are created as virtual geo-fences using
Google map and the cost of crossing the fence is defined. The user is tracked via his GPS enabled device
and the payment is made automatically from his credits purchased.

1.1 Methodology
The Rational Unified Process brings together elements from all of the generic process models,
supports iteration and illustrates good practice in specification and design. The RUP is normally described
from three perspectives:


A dynamic perspective that shows the phases of the model over time



A static perspective that shows the process activities that are enacted



A practice perspective that suggests good practices to be used during the process

Toll Application | Omnificence

Page 3
TOLL APPLICATION

Inception
The goal of the inception phase is to establish a business case for the system. Identifying all
external entities that will interact with the system and defining these interactions. This information is used
to assess the contribution of system to business.

Elaboration
The goals of the elaboration phase are to develop an understanding of the problem domain,
establish an architectural framework, develop project plan and identify key project risks.

Construction
This phase is concerned with system design, programming and testing. Parts of the system are
developed in parallel and integrated during this phase.

Transition
This is the final phase of RUP and is concerned with moving the system from the development
community to the user community and making it work in real environment.

1.2 Purpose
Toll App is a mobile application developed for automatic and easy payment in Toll gates. Toll
App is a useful and convenient application that spares you the trouble of stopping your vehicle and makes
the payment in Toll gate. This application helps people to automatically pay their charge while crossing
toll fences. The application which we develop here uses state of the art technology to track user’s location
accurately and secure payment.

1.3 Scope


There are two basic users – Administrator, US Peoples, who drive the vehicle across the States.



Administrator has an ability to manage geo fences using Google map.



Administrator has the ability to provide the notification message to the logged users via webpage.



Users should provide their identities in the Toll App website.



Users should download the Android application from Google play and connect to the server by
using his credentials provided by the administrator.



Users can be able to purchase credits using credit cards/pay pal account/debit card.



Users can view his history about the payments made.



Users can receive notification about the charges when he crosses the fences that created in
Google map.

Toll Application | Omnificence

Page 4
TOLL APPLICATION

1.4 Definitions, Acronyms and Abbreviations
AJAX - Asynchronous JavaScript and XML is about updating parts of a web page, without reloading the
whole page.

API – Application Programming Interface
Database platform (Microsoft SQL Server 2008) – MS SQL Server is the database management
system that delivers a flexible and cost effective database platform to build robust on demand business
applications and supports the .NET and web services standards.

IIS – Internet Information Service is an application server that runs and supports .NET and web service
applications.

UML - Unified Modeling Language is a standard language for writing software blueprints. The UML
may be used to visualize, specify, construct and document

XML - eXtensible Markup Language is a text based format that let developers describe, deliver and
exchange structured data between a range of applications to client for display and manipulation.

ASPX - Active Server Pages extended is used to create dynamic web content.
C# -

C# is a multi-paradigm programming language encompassing strong typing, imperative,

declarative, functional, generic, object-oriented (class-based), and component-oriented programming
disciplines.

HTTP - Hypertext Transfer Protocol is a transaction oriented client/server protocol between web browser
and a Web Server.

1.5 References


Microsoft documentation (MSDN)



Object Oriented Modeling and Design with UML - Michael Blaha, James Rambaugh.



Professional Android Application Development – Reto Meier

Toll Application | Omnificence

Page 5
TOLL APPLICATION

1.6 Technologies to be used


.NET : .NET Framework is a software framework developed by Microsoft that runs primarily
on Microsoft Windows includes a large library and provides language interoperability



AJAX : Updating parts of a web page, without reloading the whole page.



SOA : Set of principles and methodologies for designing and developing software in the form
of interoperable services.




UML : Standard for writing software blueprints, and used to visualize, specify, construct and
document.
XML : XML is a text based format that let developers describe, deliver and exchange
structured data between a range of applications to client for display and manipulation.

1.7 Tools to be used
Rational Rose
Rational Rose is an object-oriented programming (OOP) and unified modeling language (UML)
tool to design enterprise-level software applications and components. It creates visual software
application models under object-oriented principles. Example application models include the creation of
actors, use cases, relationships, entities, etc.

Eclipse
Eclipse is a multi-language software development environment comprising an integrated
development environment (IDE) and an extensible plug-in system.

MS Visual Studio 2005 – Microsoft Visual Studio is an integrated development environment (IDE)
from Microsoft used to develop console and graphical user interface applications along with Windows
Forms applications, web sites, web applications, and web services in both native code together with
managed code for all platforms

Microsoft SQL Server 2008 – MS SQL Server is the database management system that delivers a
flexible and cost effective database platform to build robust on demand business applications and supports
the .NET and web services standards.

IIS – Internet Information Service is an application server that runs and supports .NET and web service
applications

Toll Application | Omnificence

Page 6
TOLL APPLICATION

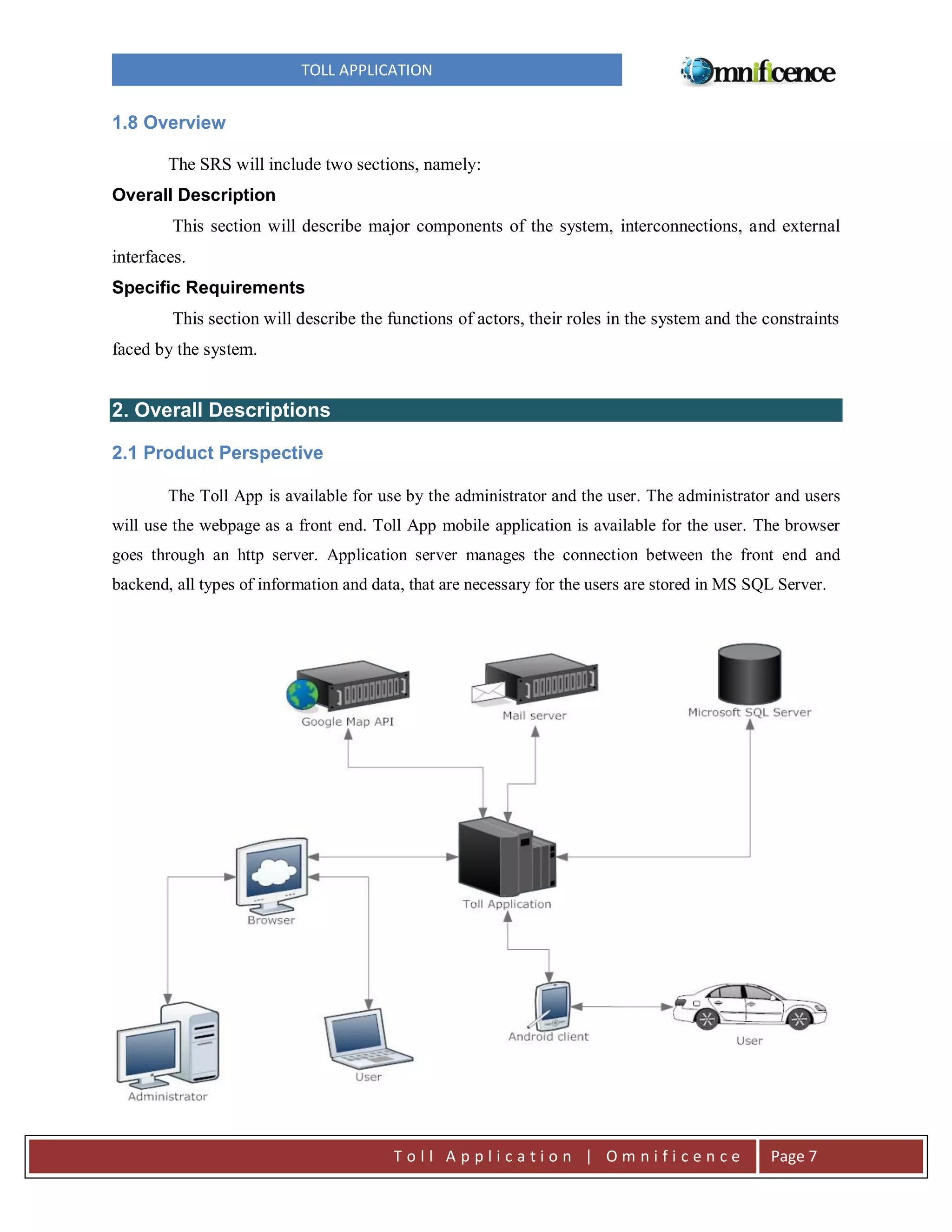

1.8 Overview
The SRS will include two sections, namely:
Overall Description
This section will describe major components of the system, interconnections, and external
interfaces.
Specific Requirements
This section will describe the functions of actors, their roles in the system and the constraints
faced by the system.

2. Overall Descriptions
2.1 Product Perspective
The Toll App is available for use by the administrator and the user. The administrator and users
will use the webpage as a front end. Toll App mobile application is available for the user. The browser
goes through an http server. Application server manages the connection between the front end and
backend, all types of information and data, that are necessary for the users are stored in MS SQL Server.

Toll Application | Omnificence

Page 7
TOLL APPLICATION

2.2 Product Functions


Web application should have registration and login facility



Application should support payment for users to pay for the application service.



Application should have two kind users, normal users and administrator users.



Administrator should able to manage users like activating/deactivating accounts, set password for
users, delete an account, set application level settings like frequency of GPS signal to the server
from client.



Administrator should be able to create/edit/delete geo fences using Google map and it should be
stored in database.



Circle and Polygon type fences should be supported.



Administrator should able to set charge for a fence when client pass through it.



Administrator should able to set dependent fence for a fence to charge a fence. For example, if
client pass first fence A then fence B, client will be charged X amount for crossing B. if client
pass first fence C, then fence B then client will be charged Y amount for crossing B.



There should facility to report history charges and purchases made to/by client.



On each charge customer should be notified via Notification Service.



Customer should be able to purchase credits using credit cards/pay pal account/debit cards



Android client should be able to read GPS signal for every X distance and sent to server.



Android client should be able to login into server using credentials passed by customer.



Only one account should be used in one device at a time. If the same account is used in another
device, logout the first one.



Report should able to save it as .CSV file (comma separate values).



Web application should have API to login, send GPS location, and get last transaction
information for client Android application to work.



Website should have facility to retrieve forgot password.

Toll Application | Omnificence

Page 8
TOLL APPLICATION

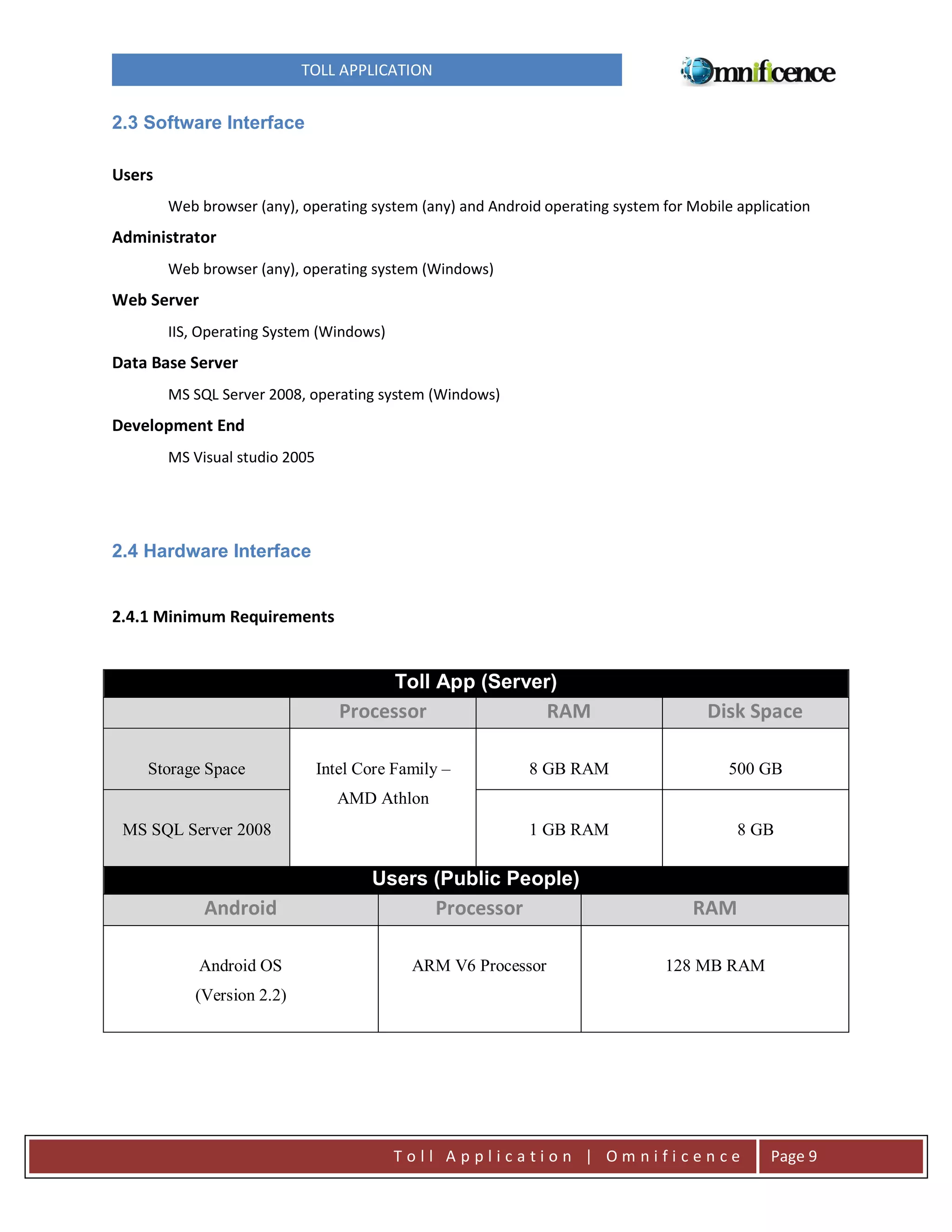

2.3 Software Interface
Users
Web browser (any), operating system (any) and Android operating system for Mobile application

Administrator
Web browser (any), operating system (Windows)

Web Server
IIS, Operating System (Windows)

Data Base Server
MS SQL Server 2008, operating system (Windows)

Development End
MS Visual studio 2005

2.4 Hardware Interface

2.4.1 Minimum Requirements

Toll App (Server)

Processor
Storage Space

RAM

Disk Space

Intel Core Family –

8 GB RAM

500 GB

1 GB RAM

8 GB

AMD Athlon
MS SQL Server 2008

Users (Public People)

Android

Processor

RAM

Android OS

ARM V6 Processor

128 MB RAM

(Version 2.2)

Toll Application | Omnificence

Page 9
TOLL APPLICATION

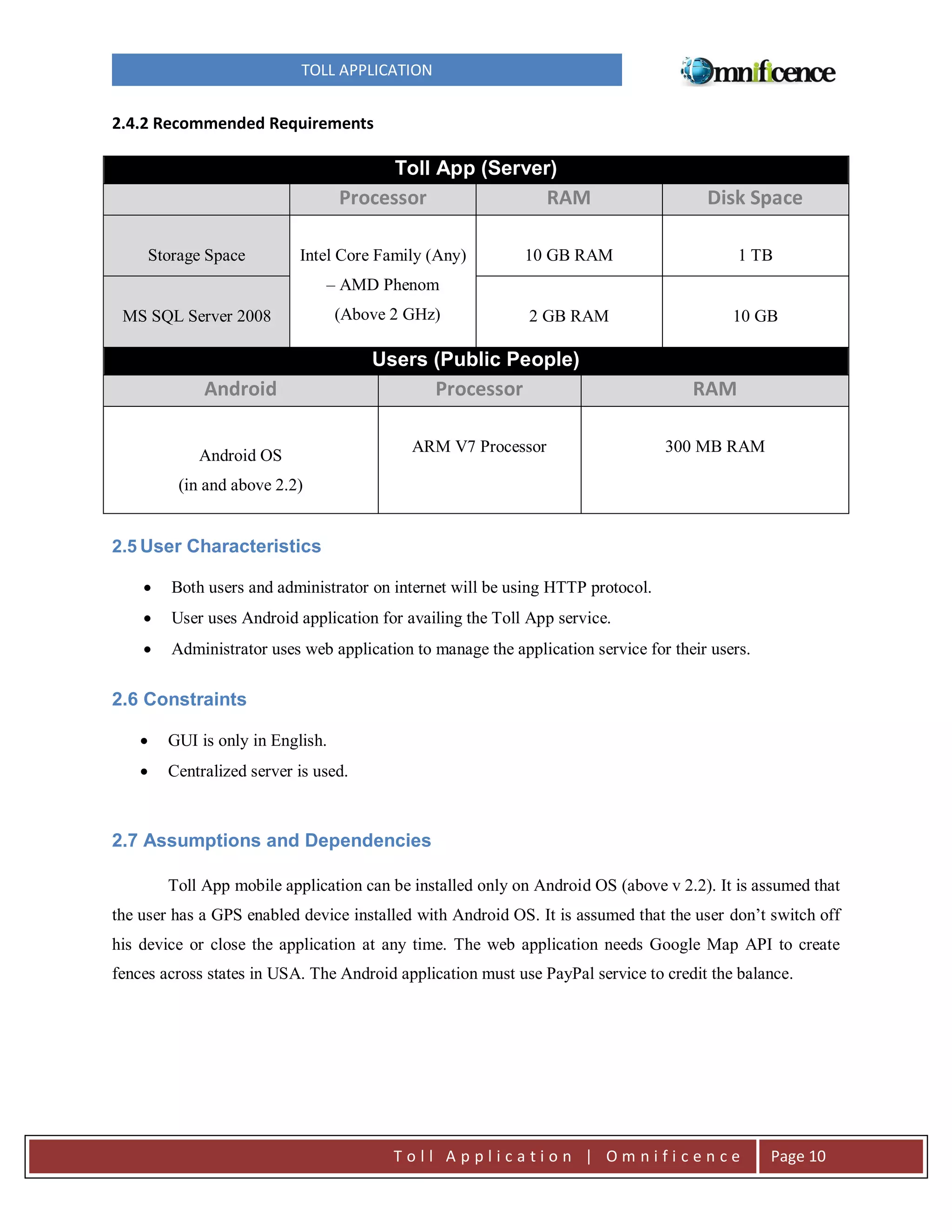

2.4.2 Recommended Requirements

Toll App (Server)

Processor
Storage Space

RAM

Disk Space

Intel Core Family (Any)

10 GB RAM

1 TB

2 GB RAM

10 GB

– AMD Phenom
MS SQL Server 2008

(Above 2 GHz)

Users (Public People)

Android
Android OS

Processor

RAM

ARM V7 Processor

300 MB RAM

(in and above 2.2)

2.5 User Characteristics


Both users and administrator on internet will be using HTTP protocol.



User uses Android application for availing the Toll App service.



Administrator uses web application to manage the application service for their users.

2.6 Constraints


GUI is only in English.



Centralized server is used.

2.7 Assumptions and Dependencies
Toll App mobile application can be installed only on Android OS (above v 2.2). It is assumed that
the user has a GPS enabled device installed with Android OS. It is assumed that the user don’t switch off
his device or close the application at any time. The web application needs Google Map API to create
fences across states in USA. The Android application must use PayPal service to credit the balance.

Toll Application | Omnificence

Page 10
TOLL APPLICATION

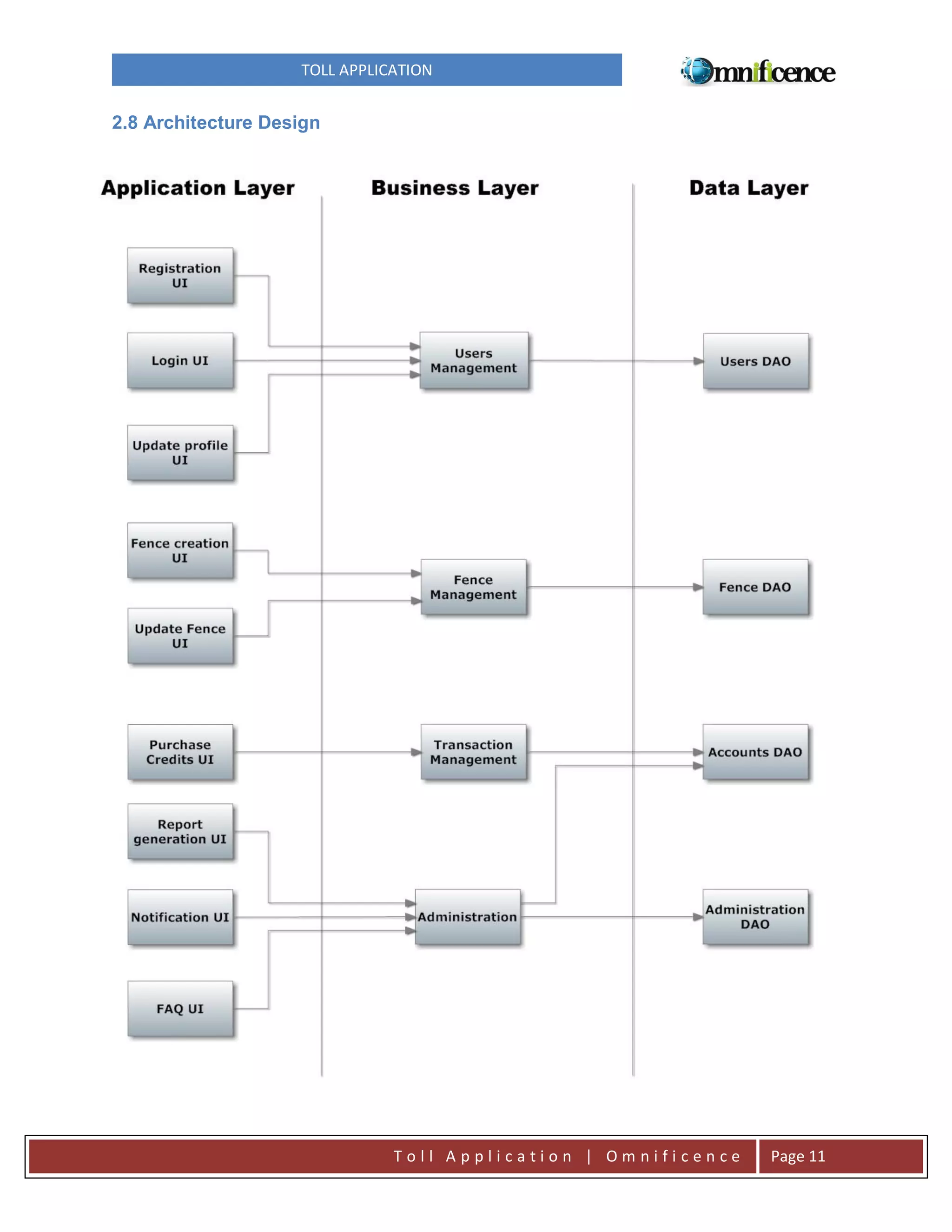

2.8 Architecture Design

Toll Application | Omnificence

Page 11
TOLL APPLICATION

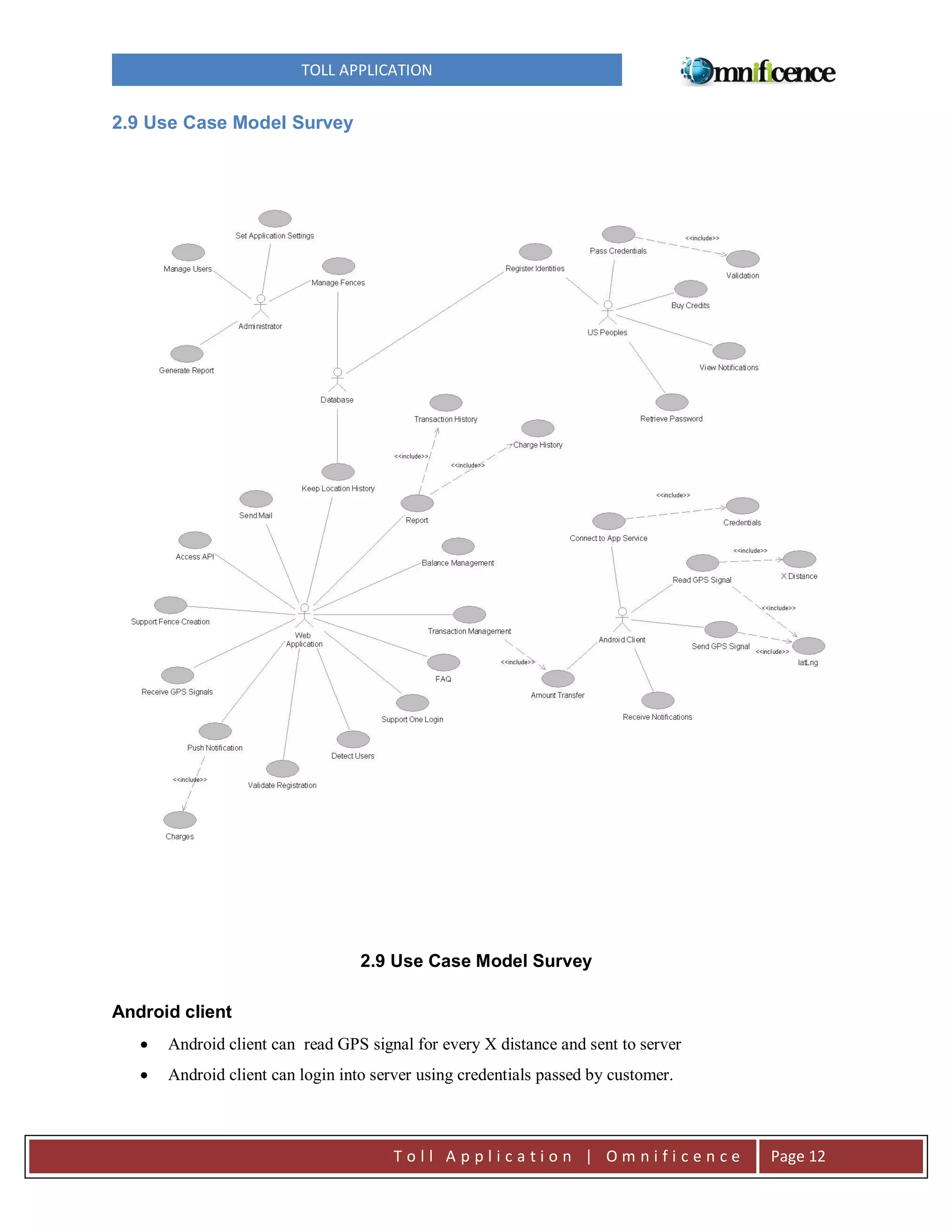

2.9 Use Case Model Survey

2.9 Use Case Model Survey
Android client


Android client can read GPS signal for every X distance and sent to server



Android client can login into server using credentials passed by customer.

Toll Application | Omnificence

Page 12
TOLL APPLICATION

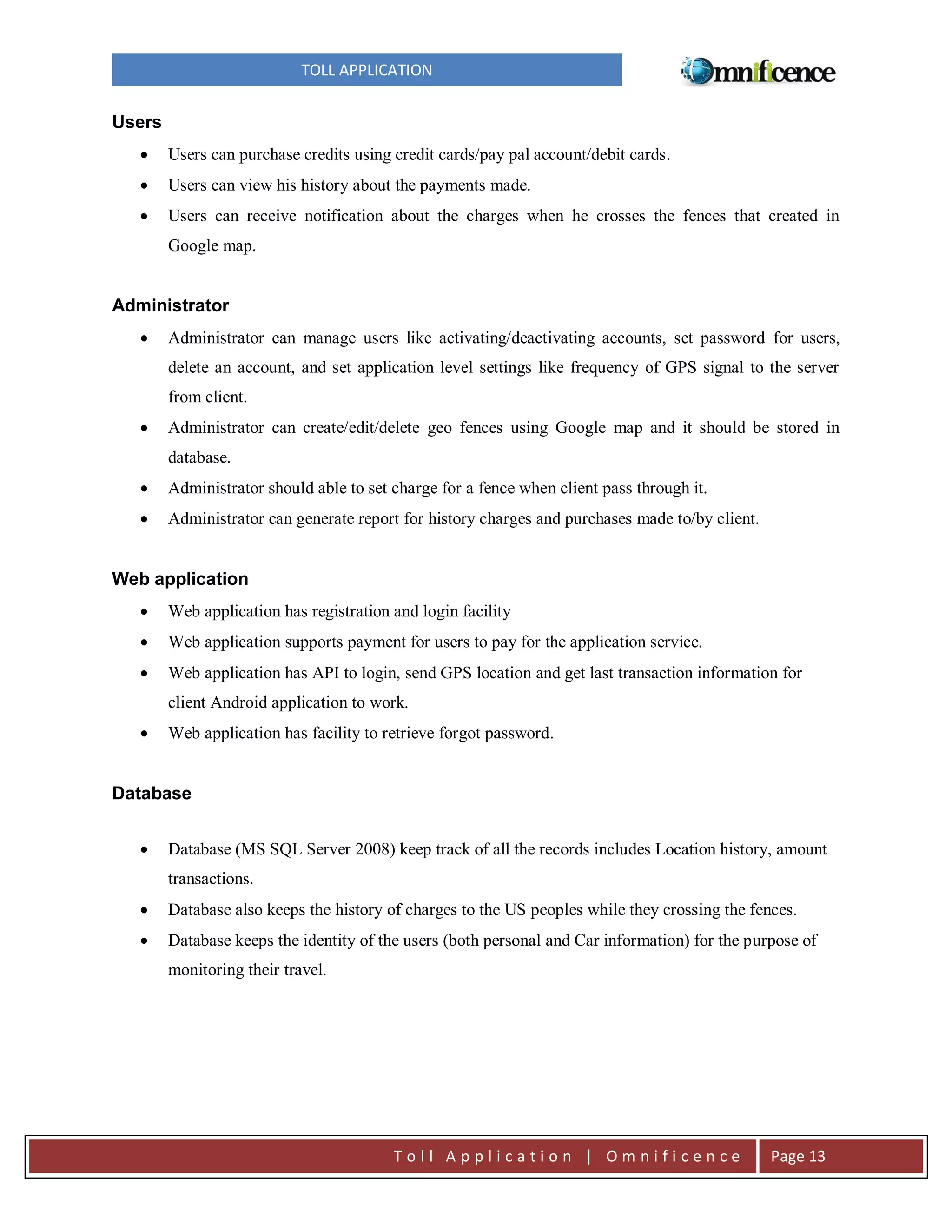

Users


Users can purchase credits using credit cards/pay pal account/debit cards.



Users can view his history about the payments made.



Users can receive notification about the charges when he crosses the fences that created in
Google map.

Administrator


Administrator can manage users like activating/deactivating accounts, set password for users,
delete an account, and set application level settings like frequency of GPS signal to the server
from client.



Administrator can create/edit/delete geo fences using Google map and it should be stored in
database.



Administrator should able to set charge for a fence when client pass through it.



Administrator can generate report for history charges and purchases made to/by client.

Web application


Web application has registration and login facility



Web application supports payment for users to pay for the application service.



Web application has API to login, send GPS location and get last transaction information for
client Android application to work.



Web application has facility to retrieve forgot password.

Database


Database (MS SQL Server 2008) keep track of all the records includes Location history, amount
transactions.



Database also keeps the history of charges to the US peoples while they crossing the fences.



Database keeps the identity of the users (both personal and Car information) for the purpose of
monitoring their travel.

Toll Application | Omnificence

Page 13
TOLL APPLICATION

2.10 ER Diagram

Toll Application | Omnificence

Page 14
TOLL APPLICATION

3. Specific Requirements
3.1 Use Case Reports

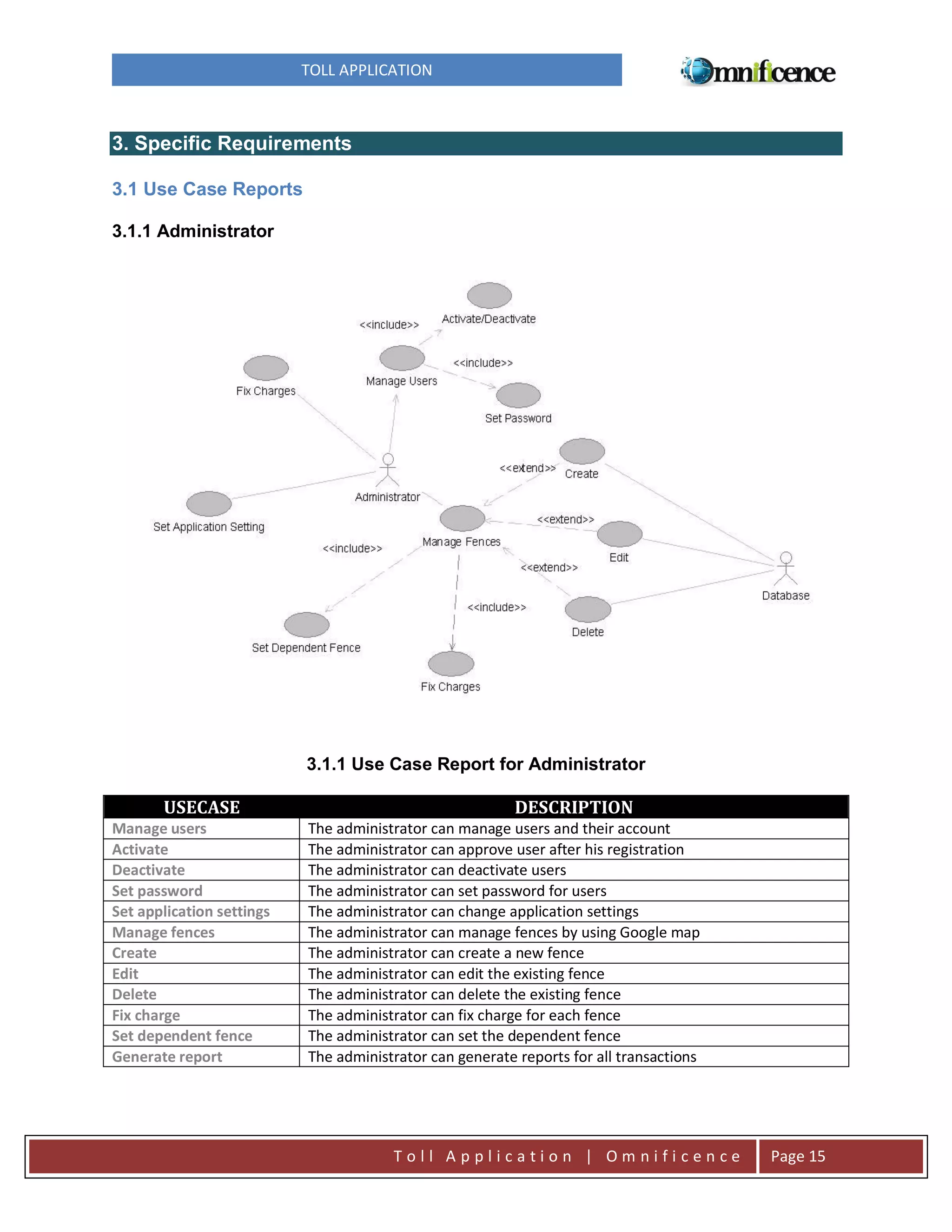

3.1.1 Administrator

3.1.1 Use Case Report for Administrator

USECASE
Manage users
Activate
Deactivate
Set password
Set application settings
Manage fences
Create
Edit
Delete
Fix charge
Set dependent fence
Generate report

DESCRIPTION
The administrator can manage users and their account
The administrator can approve user after his registration
The administrator can deactivate users
The administrator can set password for users
The administrator can change application settings
The administrator can manage fences by using Google map
The administrator can create a new fence
The administrator can edit the existing fence
The administrator can delete the existing fence
The administrator can fix charge for each fence
The administrator can set the dependent fence
The administrator can generate reports for all transactions

Toll Application | Omnificence

Page 15
TOLL APPLICATION

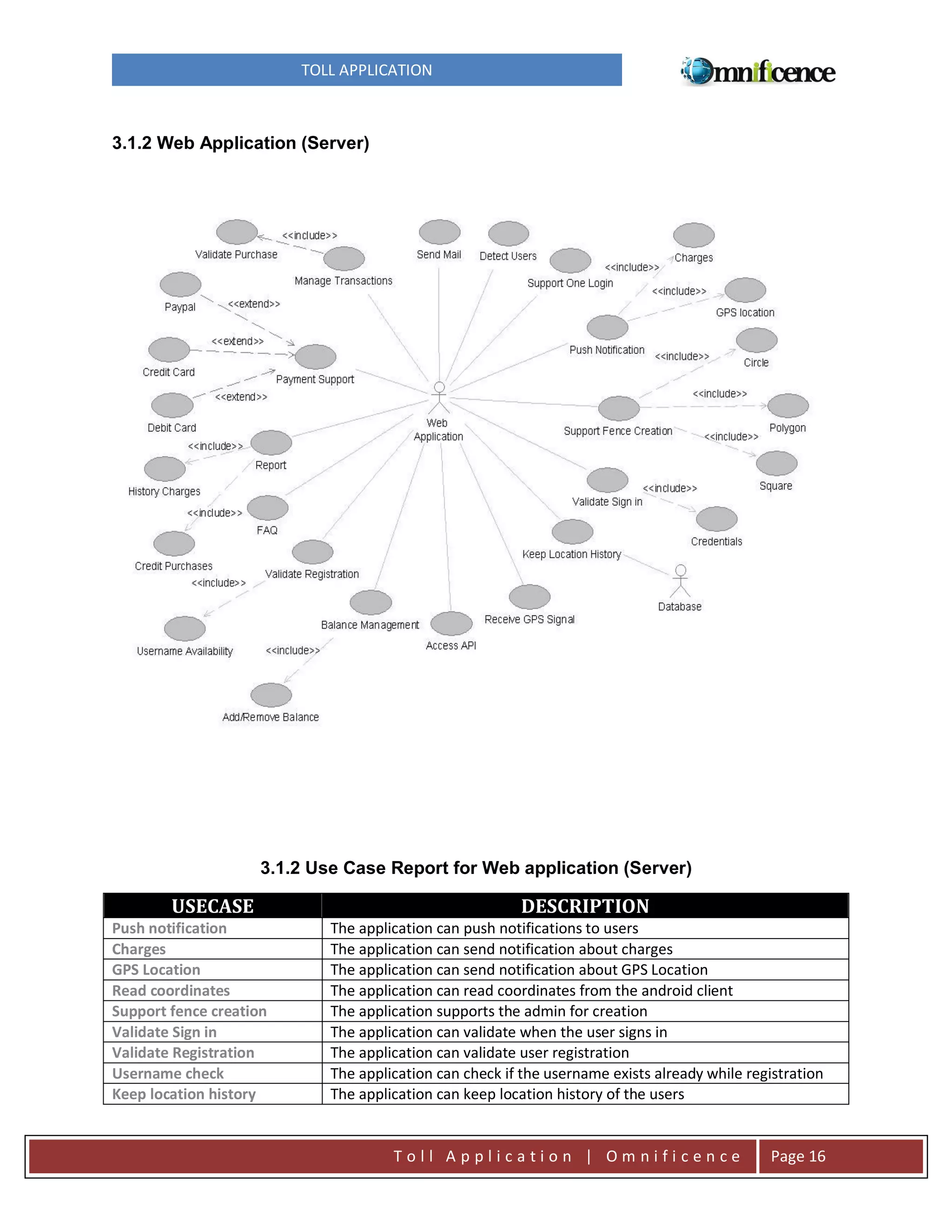

3.1.2 Web Application (Server)

3.1.2 Use Case Report for Web application (Server)

USECASE
Push notification
Charges
GPS Location
Read coordinates
Support fence creation
Validate Sign in
Validate Registration
Username check
Keep location history

DESCRIPTION
The application can push notifications to users
The application can send notification about charges
The application can send notification about GPS Location
The application can read coordinates from the android client
The application supports the admin for creation
The application can validate when the user signs in
The application can validate user registration
The application can check if the username exists already while registration
The application can keep location history of the users

Toll Application | Omnificence

Page 16
TOLL APPLICATION

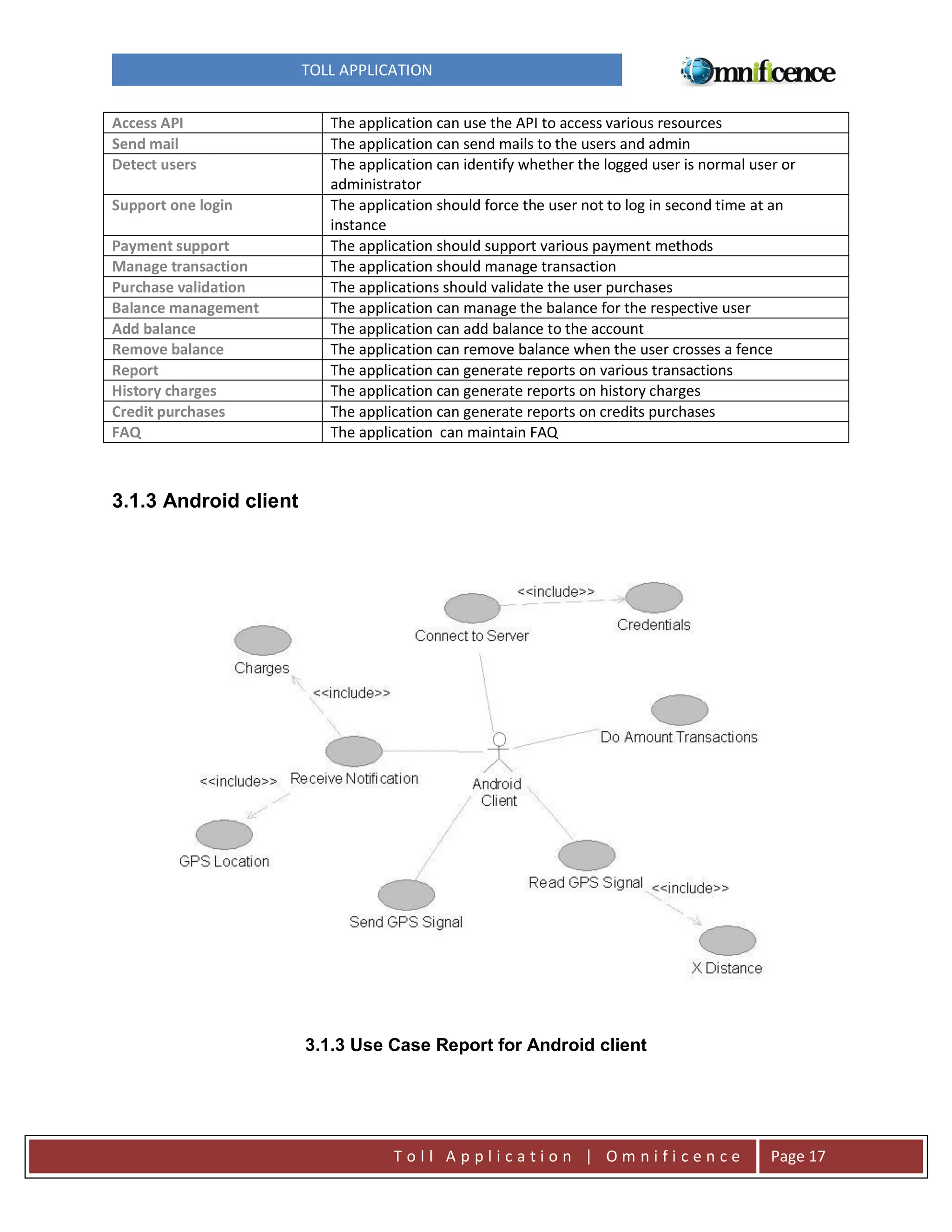

Access API
Send mail
Detect users
Support one login
Payment support
Manage transaction
Purchase validation
Balance management
Add balance
Remove balance
Report
History charges
Credit purchases
FAQ

The application can use the API to access various resources
The application can send mails to the users and admin
The application can identify whether the logged user is normal user or
administrator
The application should force the user not to log in second time at an
instance
The application should support various payment methods
The application should manage transaction
The applications should validate the user purchases
The application can manage the balance for the respective user
The application can add balance to the account
The application can remove balance when the user crosses a fence
The application can generate reports on various transactions
The application can generate reports on history charges
The application can generate reports on credits purchases
The application can maintain FAQ

3.1.3 Android client

3.1.3 Use Case Report for Android client

Toll Application | Omnificence

Page 17
TOLL APPLICATION

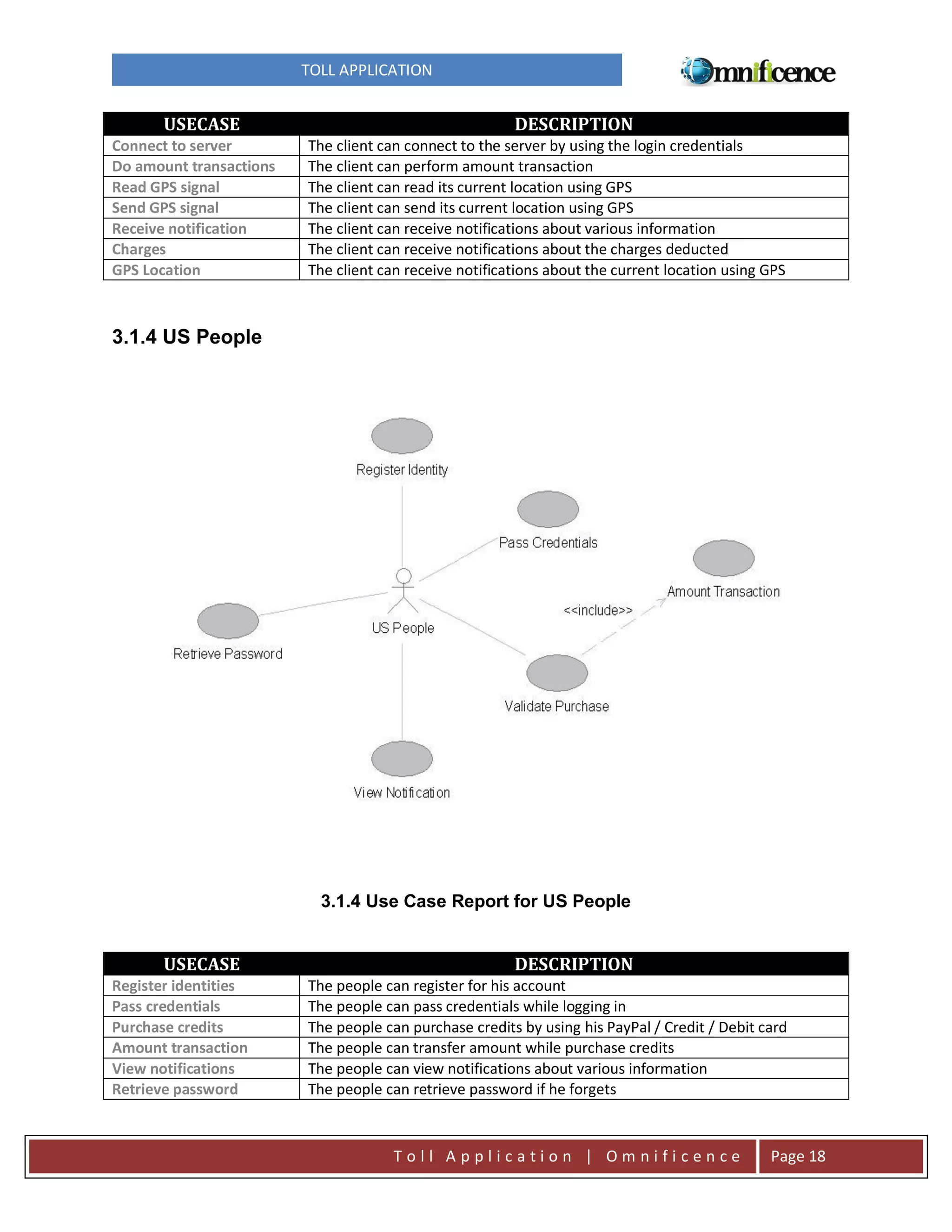

USECASE
Connect to server
Do amount transactions
Read GPS signal
Send GPS signal
Receive notification
Charges
GPS Location

DESCRIPTION
The client can connect to the server by using the login credentials
The client can perform amount transaction
The client can read its current location using GPS
The client can send its current location using GPS
The client can receive notifications about various information
The client can receive notifications about the charges deducted
The client can receive notifications about the current location using GPS

3.1.4 US People

3.1.4 Use Case Report for US People

USECASE
Register identities
Pass credentials
Purchase credits
Amount transaction
View notifications
Retrieve password

DESCRIPTION
The people can register for his account
The people can pass credentials while logging in
The people can purchase credits by using his PayPal / Credit / Debit card
The people can transfer amount while purchase credits
The people can view notifications about various information
The people can retrieve password if he forgets

Toll Application | Omnificence

Page 18
TOLL APPLICATION

3.2 Activity Diagrams

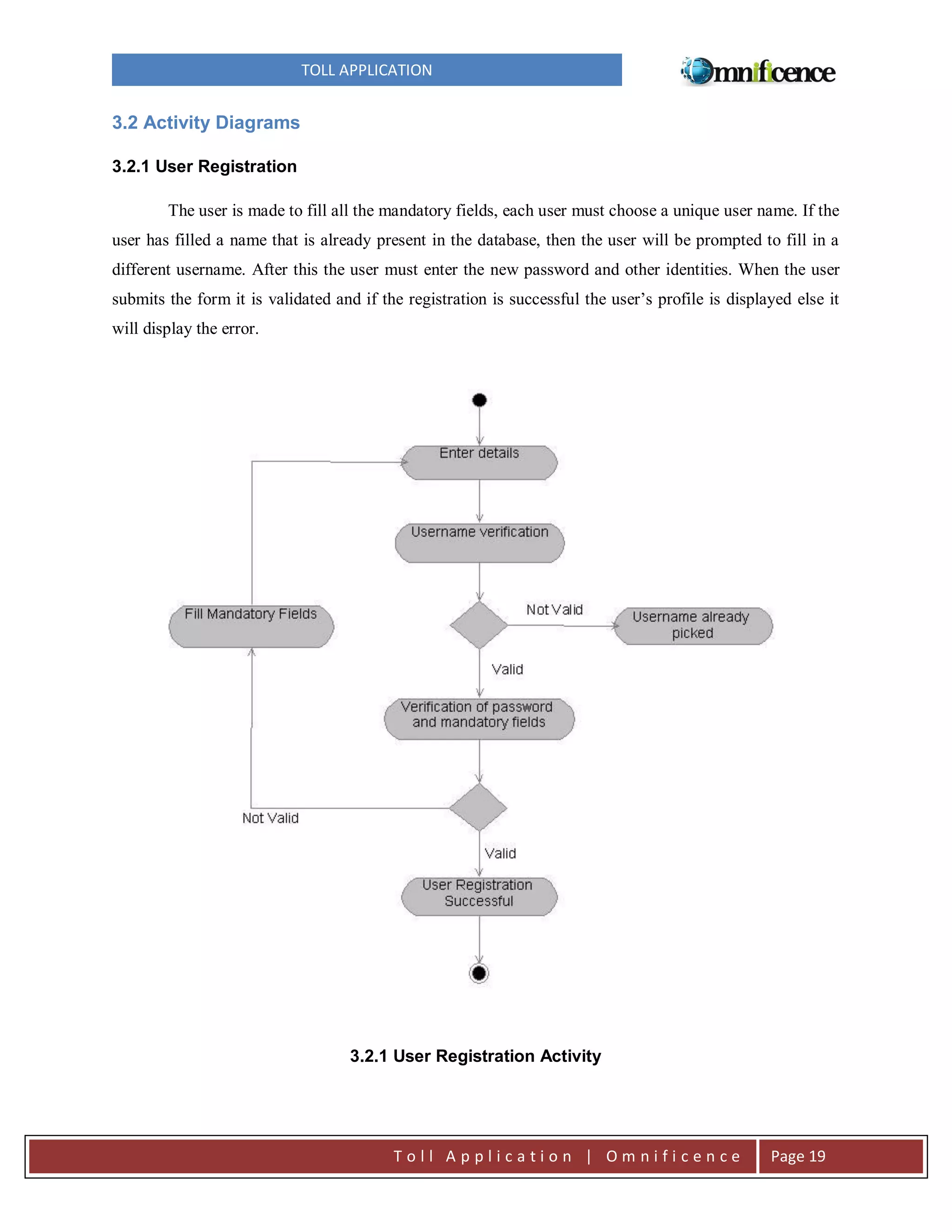

3.2.1 User Registration
The user is made to fill all the mandatory fields, each user must choose a unique user name. If the
user has filled a name that is already present in the database, then the user will be prompted to fill in a
different username. After this the user must enter the new password and other identities. When the user
submits the form it is validated and if the registration is successful the user’s profile is displayed else it
will display the error.

3.2.1 User Registration Activity

Toll Application | Omnificence

Page 19
TOLL APPLICATION
3.2.2 Login Activity
The user enters the login credentials. The System validates the login credentials. If the login
credentials are valid then the system detects the type of user. If user is a member then the system redirects
to the member’s home page. If the user is administrator then the system redirects to the administrator’s
home page.

3.2.2 Login Activity

Toll Application | Omnificence

Page 20
TOLL APPLICATION

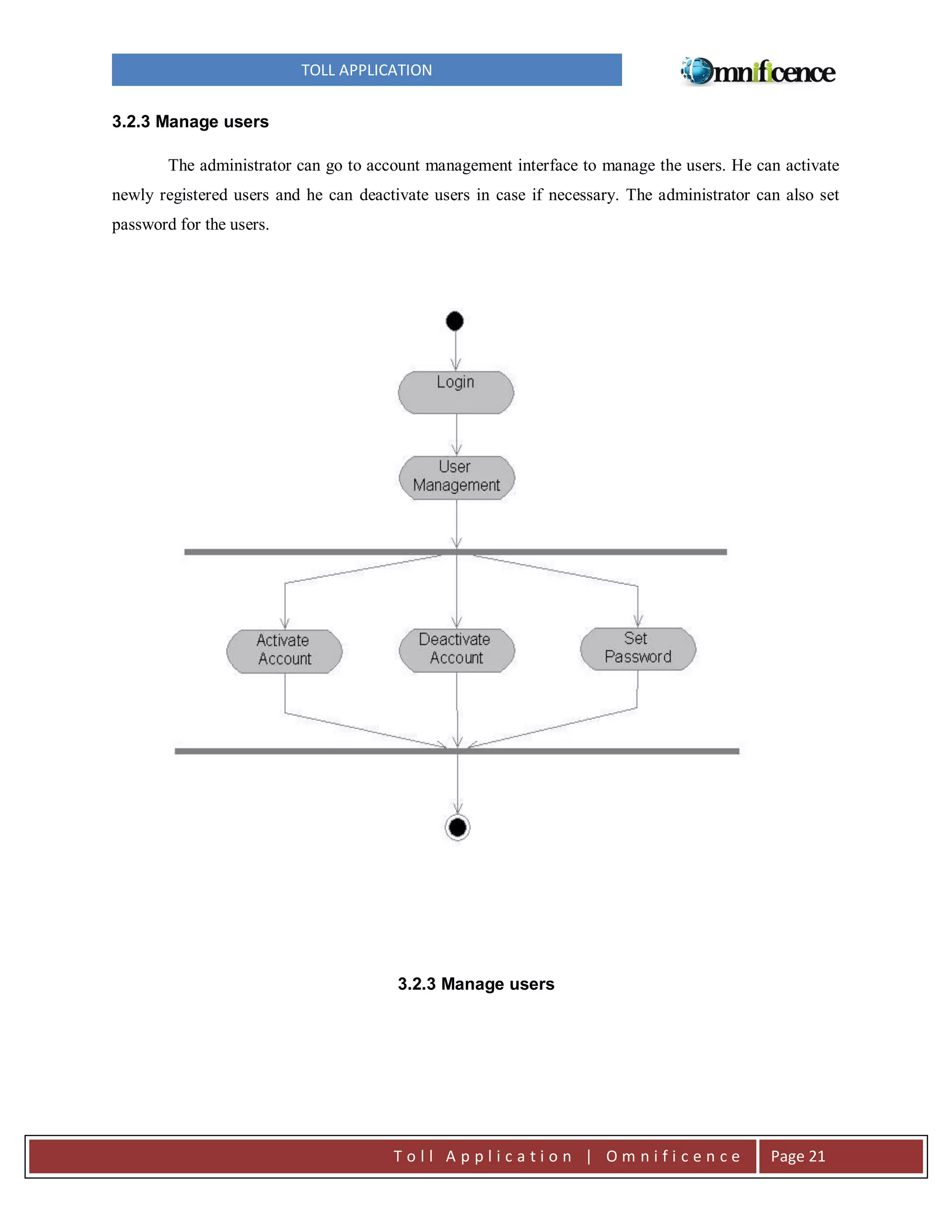

3.2.3 Manage users
The administrator can go to account management interface to manage the users. He can activate
newly registered users and he can deactivate users in case if necessary. The administrator can also set
password for the users.

3.2.3 Manage users

Toll Application | Omnificence

Page 21
TOLL APPLICATION

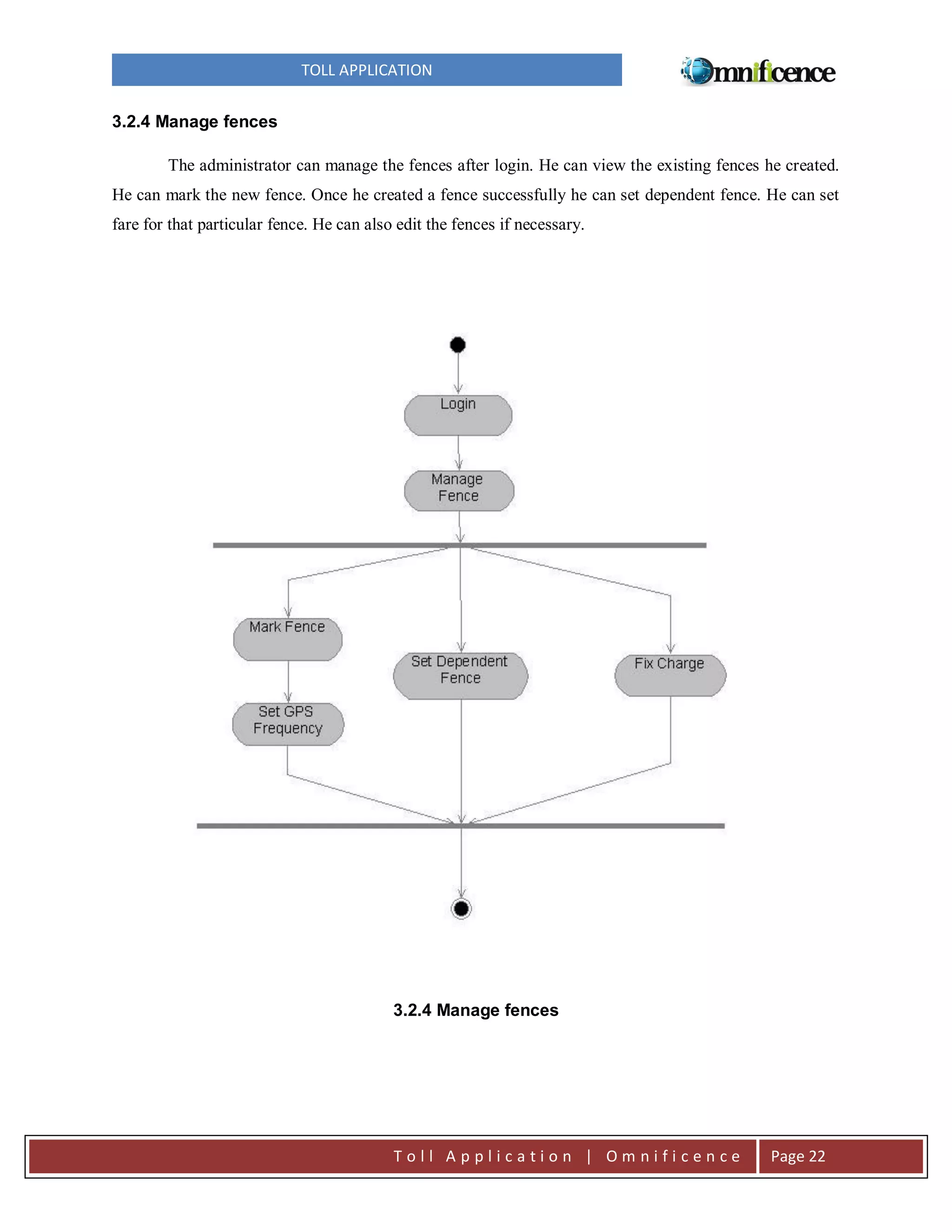

3.2.4 Manage fences
The administrator can manage the fences after login. He can view the existing fences he created.
He can mark the new fence. Once he created a fence successfully he can set dependent fence. He can set
fare for that particular fence. He can also edit the fences if necessary.

3.2.4 Manage fences

Toll Application | Omnificence

Page 22
TOLL APPLICATION

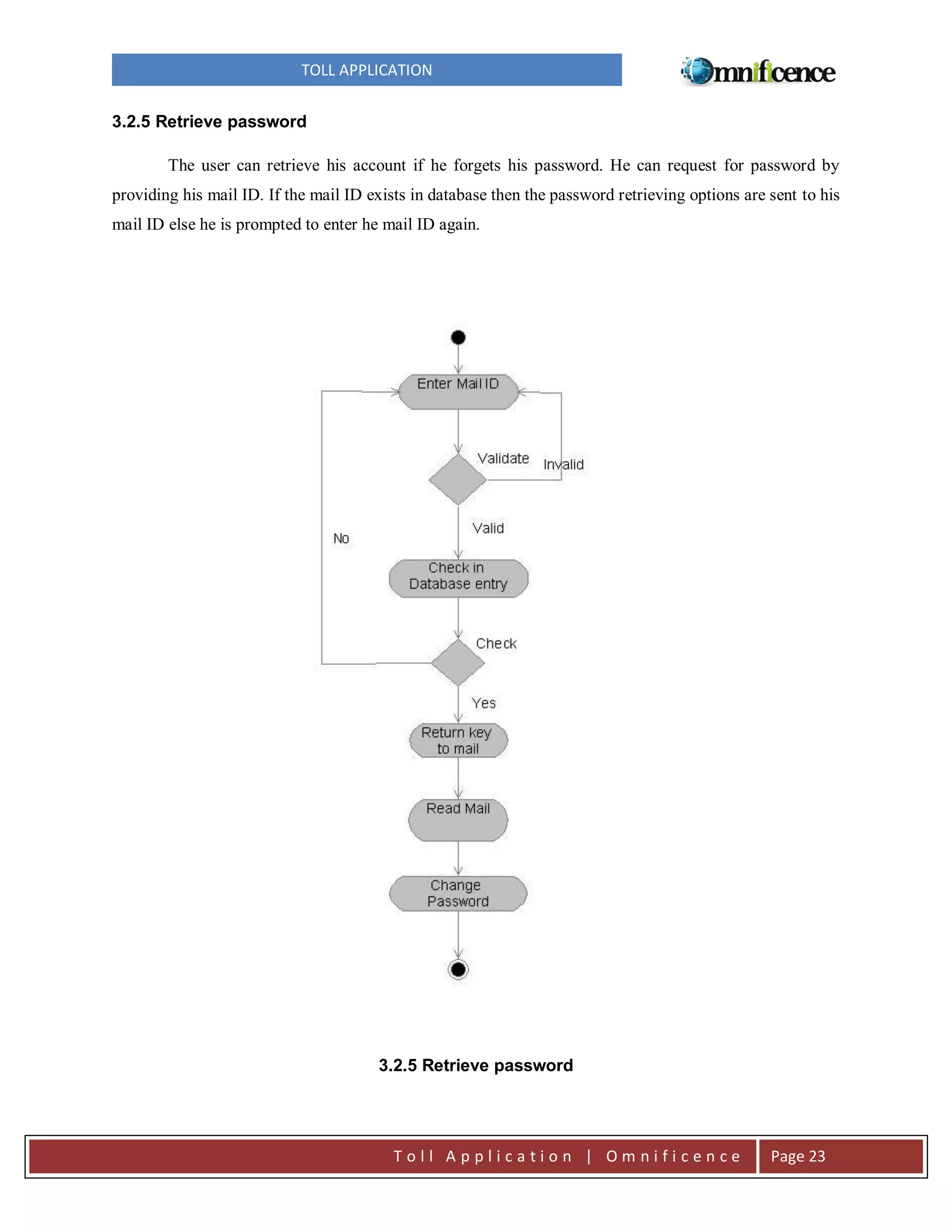

3.2.5 Retrieve password
The user can retrieve his account if he forgets his password. He can request for password by
providing his mail ID. If the mail ID exists in database then the password retrieving options are sent to his
mail ID else he is prompted to enter he mail ID again.

3.2.5 Retrieve password

Toll Application | Omnificence

Page 23
TOLL APPLICATION

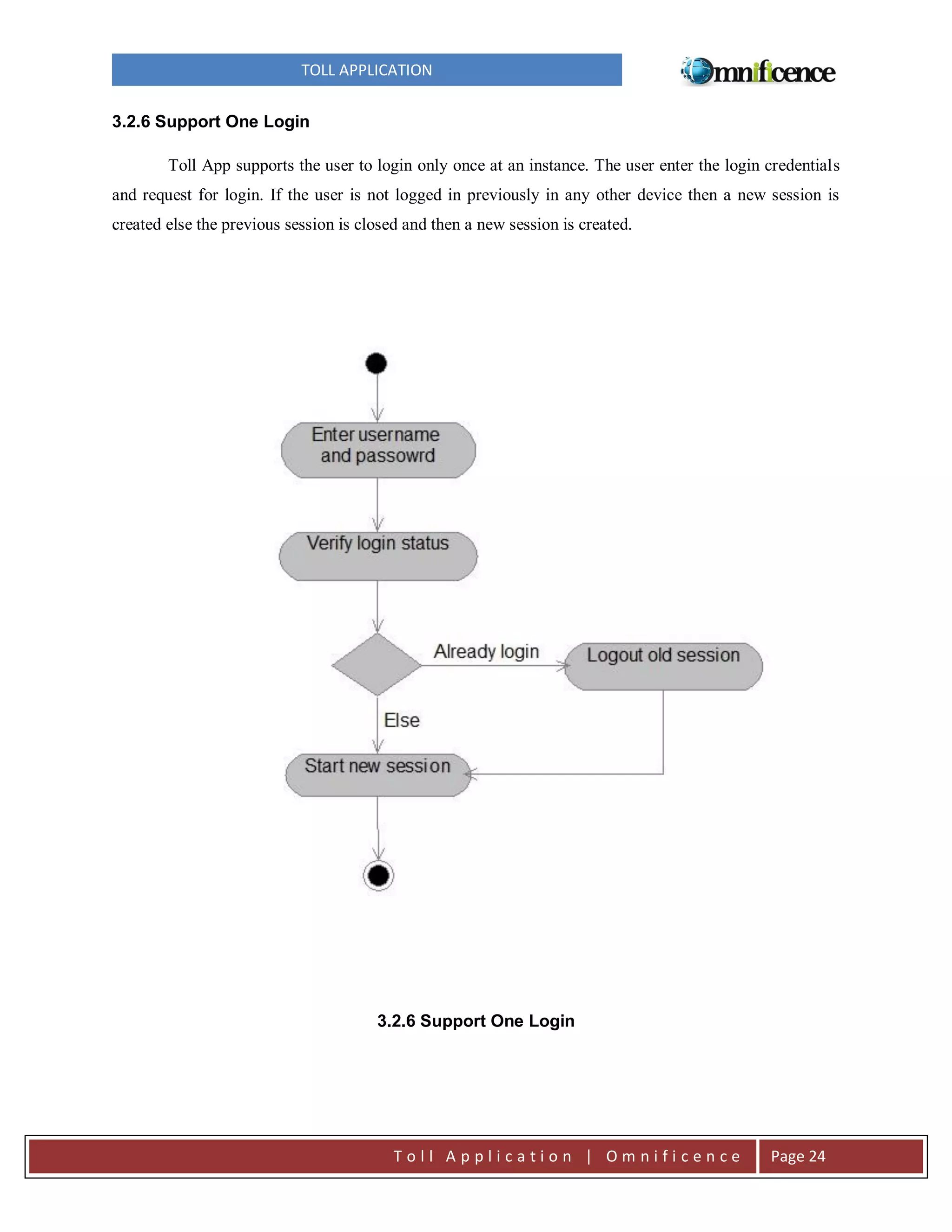

3.2.6 Support One Login
Toll App supports the user to login only once at an instance. The user enter the login credentials
and request for login. If the user is not logged in previously in any other device then a new session is
created else the previous session is closed and then a new session is created.

3.2.6 Support One Login

Toll Application | Omnificence

Page 24
TOLL APPLICATION

3.3 Sequence Diagrams

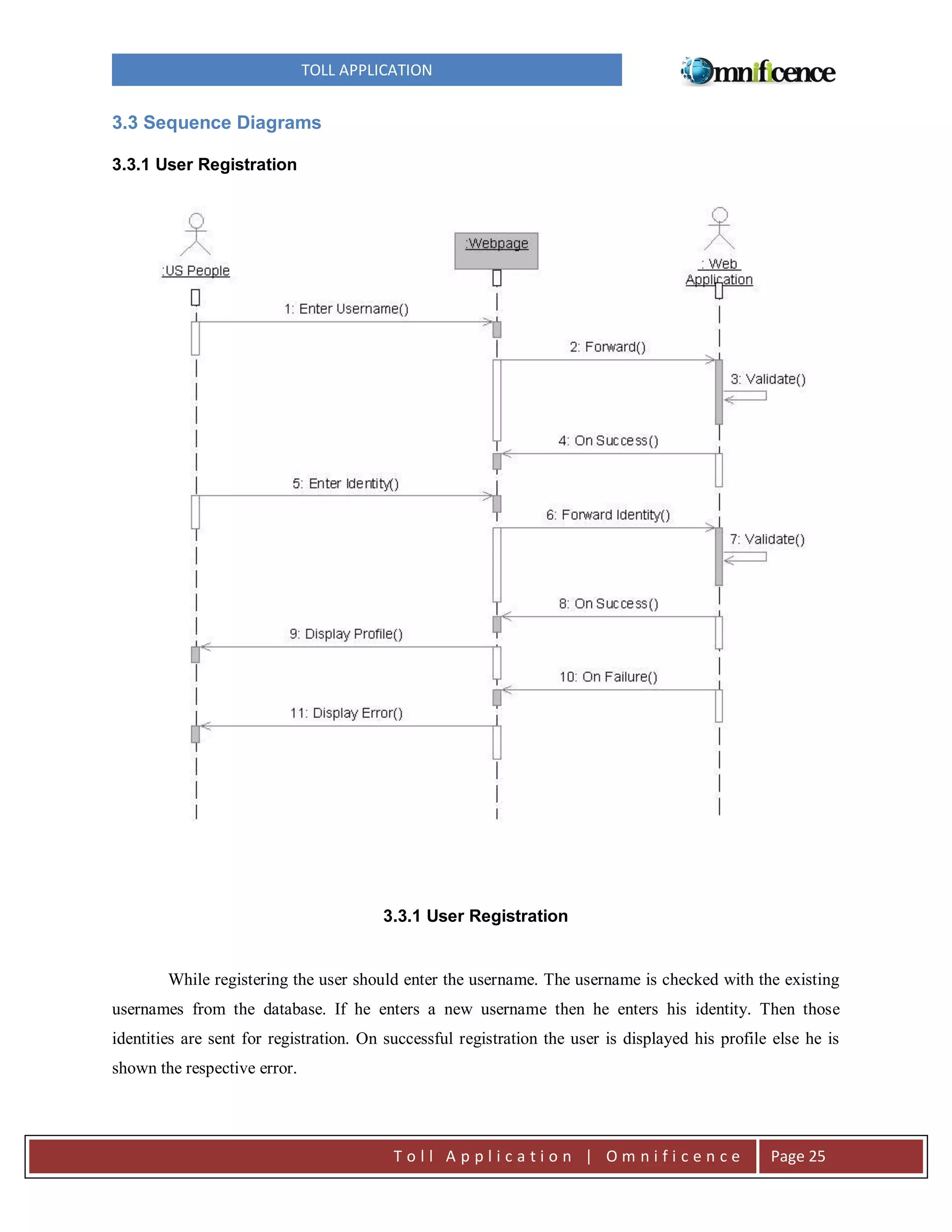

3.3.1 User Registration

3.3.1 User Registration

While registering the user should enter the username. The username is checked with the existing
usernames from the database. If he enters a new username then he enters his identity. Then those
identities are sent for registration. On successful registration the user is displayed his profile else he is
shown the respective error.

Toll Application | Omnificence

Page 25
TOLL APPLICATION

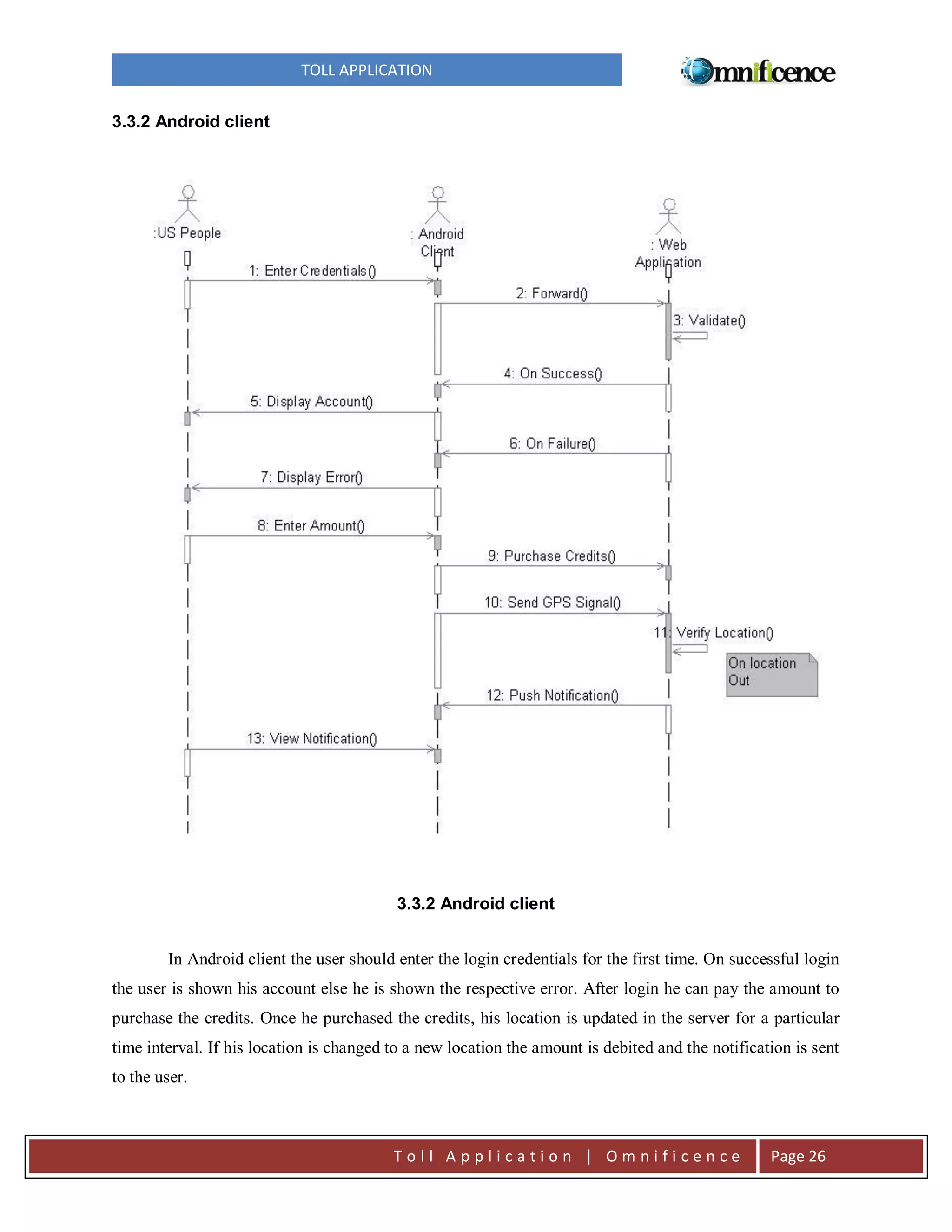

3.3.2 Android client

3.3.2 Android client
In Android client the user should enter the login credentials for the first time. On successful login
the user is shown his account else he is shown the respective error. After login he can pay the amount to
purchase the credits. Once he purchased the credits, his location is updated in the server for a particular
time interval. If his location is changed to a new location the amount is debited and the notification is sent
to the user.

Toll Application | Omnificence

Page 26
TOLL APPLICATION

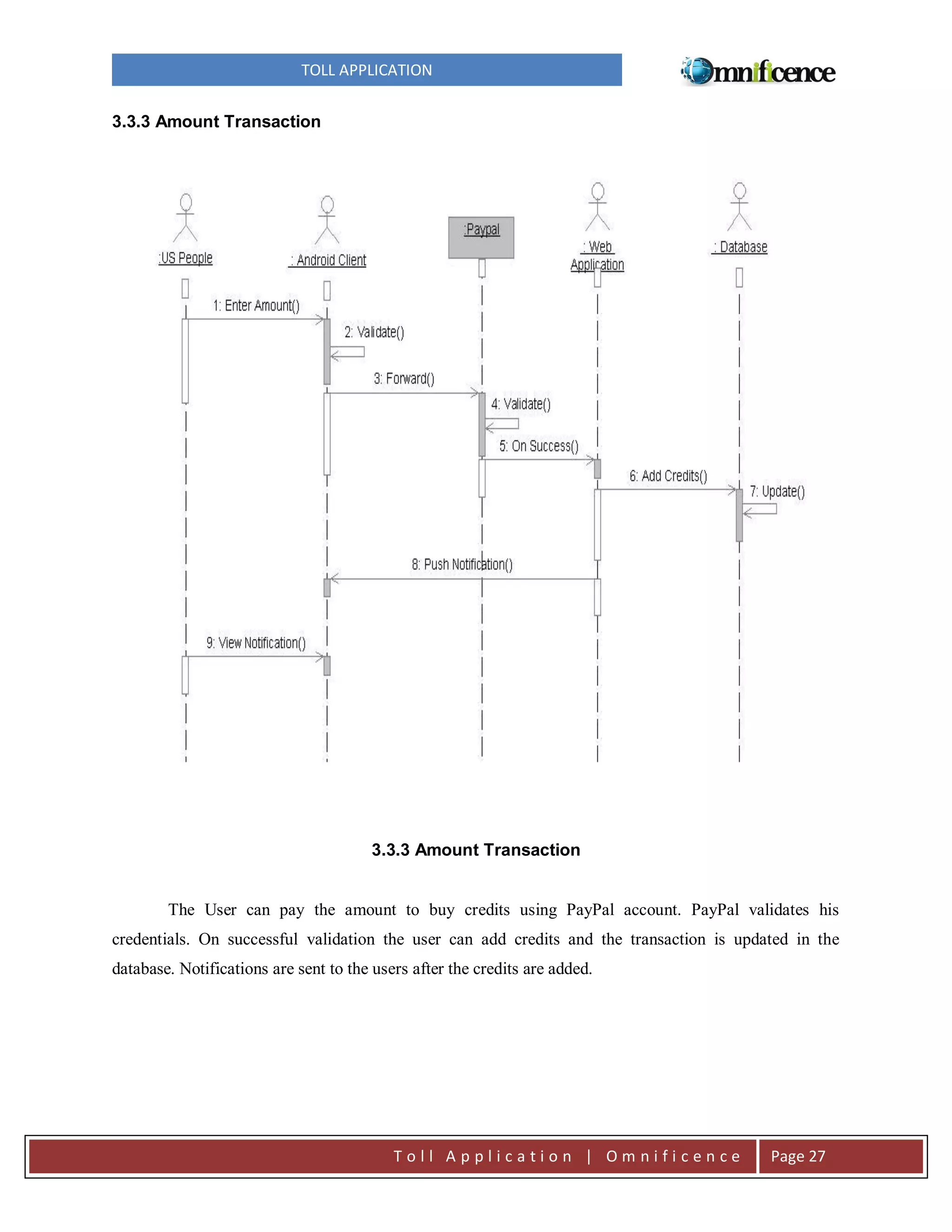

3.3.3 Amount Transaction

3.3.3 Amount Transaction

The User can pay the amount to buy credits using PayPal account. PayPal validates his
credentials. On successful validation the user can add credits and the transaction is updated in the
database. Notifications are sent to the users after the credits are added.

Toll Application | Omnificence

Page 27
TOLL APPLICATION

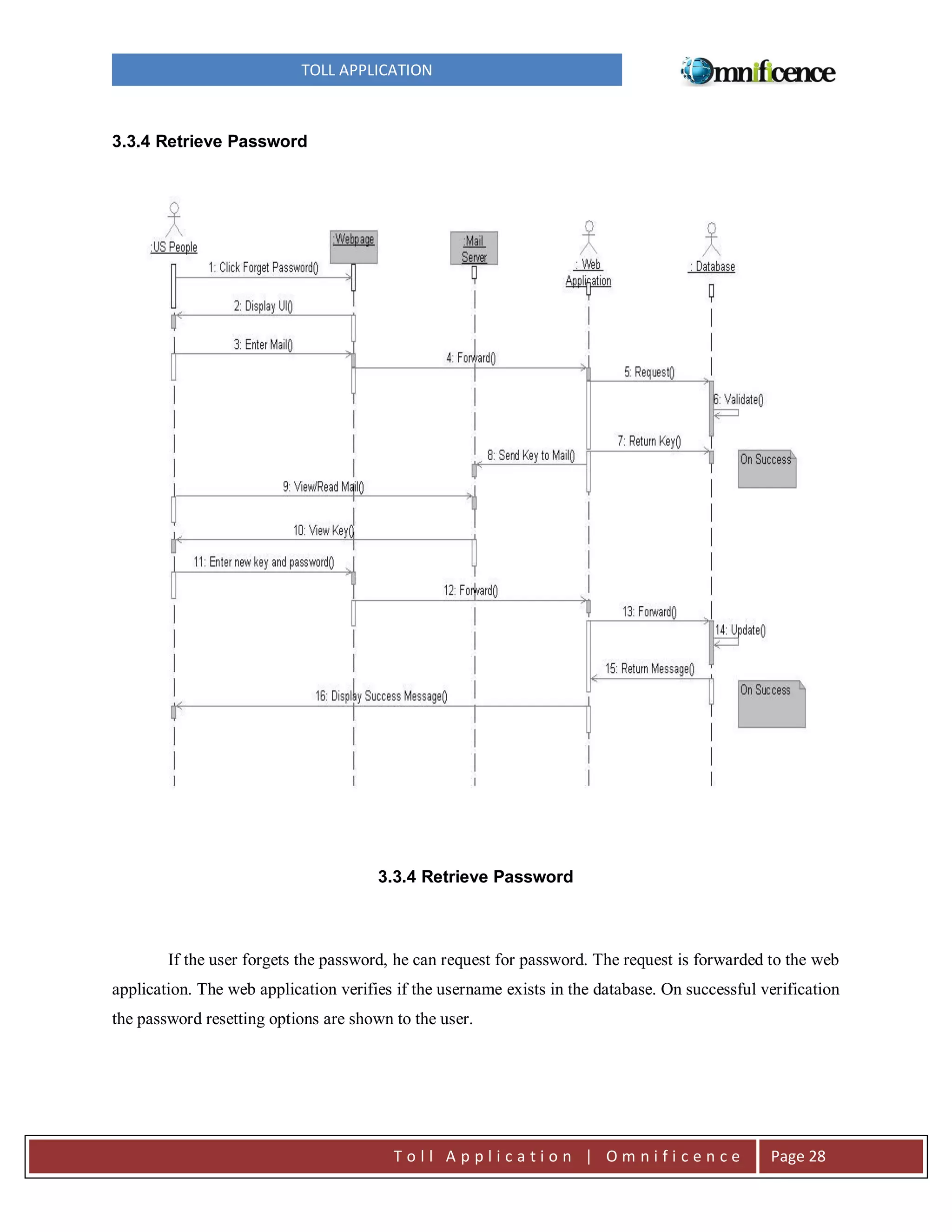

3.3.4 Retrieve Password

3.3.4 Retrieve Password

If the user forgets the password, he can request for password. The request is forwarded to the web
application. The web application verifies if the username exists in the database. On successful verification
the password resetting options are shown to the user.

Toll Application | Omnificence

Page 28
TOLL APPLICATION

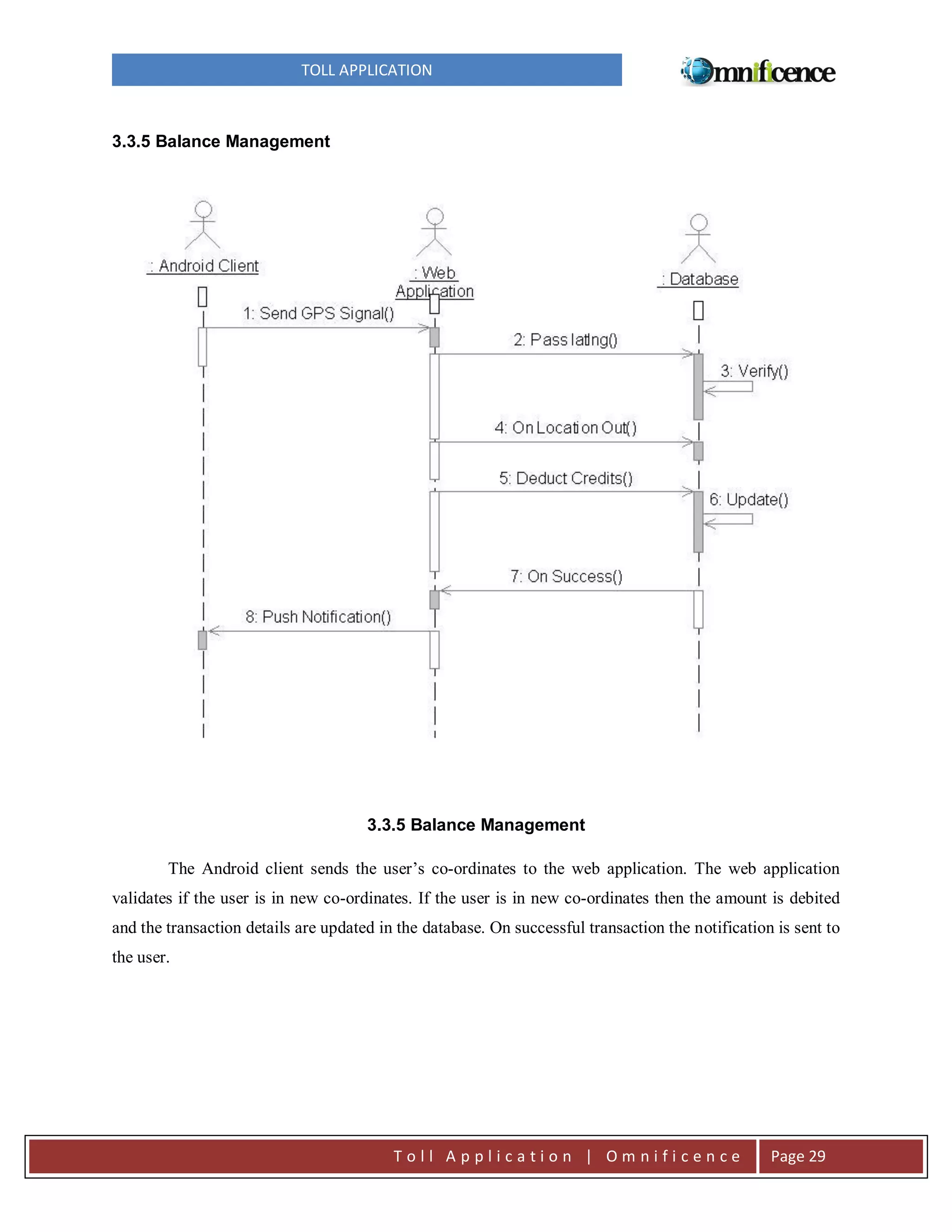

3.3.5 Balance Management

3.3.5 Balance Management
The Android client sends the user’s co-ordinates to the web application. The web application
validates if the user is in new co-ordinates. If the user is in new co-ordinates then the amount is debited
and the transaction details are updated in the database. On successful transaction the notification is sent to
the user.

Toll Application | Omnificence

Page 29
TOLL APPLICATION

Thanks to

Toll Application | Omnificence

Page 30

Toll application - .NET and Android - SRS

  • 1.
    TOLL APPLICATION Toll Application SoftwareRequirements Specification Mentor Mr.R.Jayaraj (Asst. Professor), Department of CSE Members Arun Prasath.S - 090105107008 Jojy George - 100405107005 Prabhu.E - 100405107013 Vivek Andrew Sha - 090105107121 College - Hindusthan College of Engineering and Technology, Coimbatore – 641032 Department - Computer Science and Engineering State - Tamil Nadu Toll Application | Omnificence Page 1
  • 2.
    TOLL APPLICATION Table ofContents Description Page No 1. Introduction 3-7 1.1 Methodology ………………………………………………………………………… 3 1.2 Purpose ….. ………………………………………………………………………….. 4 1.3 Scope ……. ………………………………………………………………………….. 4 1.4 Definitions, Acronyms and Abbreviations … ……………………………………….. 5 1.5 References ……….…………………………………………………………………. 5 1.6 Technologies to be used ….…………………………………………………………. 6 1.7 Tools to be used …. …………………………………………………………………. 6 1.8 Overview …………………………………………………………………………….. 7 2. Overall Description 7 - 14 2.1 Product Perspective ……….………………………………………………………… 7 2.2 Product Functions……………………………………………………………………. 8 2.3 Software Interface …………………………………………………………………. 9 2.4 Hardware Interface …………………………………………………………………. 9 2.5 User Characteristics …………………………………………………………………. 10 2.6 Constraints ………………………………………………………………………….. 10 2.7 Assumptions and Dependencies……………………………………………………… 10 2.8 Architecture Design …………………………………………………………………. 11 2.9 Use Case Model Survey ……………………………………………………………... 12 2.10 ER diagram…………………………………………………………………………. 14 3. Specific Requirements 14 - 29 3.1 Use Case Reports ……………………………………………………………………. 14 3.2 Activity Diagrams …………………………………………………………………… 19 3.3 Sequence Diagrams …………………………………………………………………. 25 Toll Application | Omnificence Page 2
  • 3.
    TOLL APPLICATION 1. Introduction InUnited States the toll gate payment requires more manual work. Toll App is an application which enables automatic payment for the Toll gate. Toll gates are created as virtual geo-fences using Google map and the cost of crossing the fence is defined. The user is tracked via his GPS enabled device and the payment is made automatically from his credits purchased. 1.1 Methodology The Rational Unified Process brings together elements from all of the generic process models, supports iteration and illustrates good practice in specification and design. The RUP is normally described from three perspectives:  A dynamic perspective that shows the phases of the model over time  A static perspective that shows the process activities that are enacted  A practice perspective that suggests good practices to be used during the process Toll Application | Omnificence Page 3
  • 4.
    TOLL APPLICATION Inception The goalof the inception phase is to establish a business case for the system. Identifying all external entities that will interact with the system and defining these interactions. This information is used to assess the contribution of system to business. Elaboration The goals of the elaboration phase are to develop an understanding of the problem domain, establish an architectural framework, develop project plan and identify key project risks. Construction This phase is concerned with system design, programming and testing. Parts of the system are developed in parallel and integrated during this phase. Transition This is the final phase of RUP and is concerned with moving the system from the development community to the user community and making it work in real environment. 1.2 Purpose Toll App is a mobile application developed for automatic and easy payment in Toll gates. Toll App is a useful and convenient application that spares you the trouble of stopping your vehicle and makes the payment in Toll gate. This application helps people to automatically pay their charge while crossing toll fences. The application which we develop here uses state of the art technology to track user’s location accurately and secure payment. 1.3 Scope  There are two basic users – Administrator, US Peoples, who drive the vehicle across the States.  Administrator has an ability to manage geo fences using Google map.  Administrator has the ability to provide the notification message to the logged users via webpage.  Users should provide their identities in the Toll App website.  Users should download the Android application from Google play and connect to the server by using his credentials provided by the administrator.  Users can be able to purchase credits using credit cards/pay pal account/debit card.  Users can view his history about the payments made.  Users can receive notification about the charges when he crosses the fences that created in Google map. Toll Application | Omnificence Page 4
  • 5.
    TOLL APPLICATION 1.4 Definitions,Acronyms and Abbreviations AJAX - Asynchronous JavaScript and XML is about updating parts of a web page, without reloading the whole page. API – Application Programming Interface Database platform (Microsoft SQL Server 2008) – MS SQL Server is the database management system that delivers a flexible and cost effective database platform to build robust on demand business applications and supports the .NET and web services standards. IIS – Internet Information Service is an application server that runs and supports .NET and web service applications. UML - Unified Modeling Language is a standard language for writing software blueprints. The UML may be used to visualize, specify, construct and document XML - eXtensible Markup Language is a text based format that let developers describe, deliver and exchange structured data between a range of applications to client for display and manipulation. ASPX - Active Server Pages extended is used to create dynamic web content. C# - C# is a multi-paradigm programming language encompassing strong typing, imperative, declarative, functional, generic, object-oriented (class-based), and component-oriented programming disciplines. HTTP - Hypertext Transfer Protocol is a transaction oriented client/server protocol between web browser and a Web Server. 1.5 References  Microsoft documentation (MSDN)  Object Oriented Modeling and Design with UML - Michael Blaha, James Rambaugh.  Professional Android Application Development – Reto Meier Toll Application | Omnificence Page 5
  • 6.
    TOLL APPLICATION 1.6 Technologiesto be used  .NET : .NET Framework is a software framework developed by Microsoft that runs primarily on Microsoft Windows includes a large library and provides language interoperability  AJAX : Updating parts of a web page, without reloading the whole page.  SOA : Set of principles and methodologies for designing and developing software in the form of interoperable services.   UML : Standard for writing software blueprints, and used to visualize, specify, construct and document. XML : XML is a text based format that let developers describe, deliver and exchange structured data between a range of applications to client for display and manipulation. 1.7 Tools to be used Rational Rose Rational Rose is an object-oriented programming (OOP) and unified modeling language (UML) tool to design enterprise-level software applications and components. It creates visual software application models under object-oriented principles. Example application models include the creation of actors, use cases, relationships, entities, etc. Eclipse Eclipse is a multi-language software development environment comprising an integrated development environment (IDE) and an extensible plug-in system. MS Visual Studio 2005 – Microsoft Visual Studio is an integrated development environment (IDE) from Microsoft used to develop console and graphical user interface applications along with Windows Forms applications, web sites, web applications, and web services in both native code together with managed code for all platforms Microsoft SQL Server 2008 – MS SQL Server is the database management system that delivers a flexible and cost effective database platform to build robust on demand business applications and supports the .NET and web services standards. IIS – Internet Information Service is an application server that runs and supports .NET and web service applications Toll Application | Omnificence Page 6
  • 7.
    TOLL APPLICATION 1.8 Overview TheSRS will include two sections, namely: Overall Description This section will describe major components of the system, interconnections, and external interfaces. Specific Requirements This section will describe the functions of actors, their roles in the system and the constraints faced by the system. 2. Overall Descriptions 2.1 Product Perspective The Toll App is available for use by the administrator and the user. The administrator and users will use the webpage as a front end. Toll App mobile application is available for the user. The browser goes through an http server. Application server manages the connection between the front end and backend, all types of information and data, that are necessary for the users are stored in MS SQL Server. Toll Application | Omnificence Page 7
  • 8.
    TOLL APPLICATION 2.2 ProductFunctions  Web application should have registration and login facility  Application should support payment for users to pay for the application service.  Application should have two kind users, normal users and administrator users.  Administrator should able to manage users like activating/deactivating accounts, set password for users, delete an account, set application level settings like frequency of GPS signal to the server from client.  Administrator should be able to create/edit/delete geo fences using Google map and it should be stored in database.  Circle and Polygon type fences should be supported.  Administrator should able to set charge for a fence when client pass through it.  Administrator should able to set dependent fence for a fence to charge a fence. For example, if client pass first fence A then fence B, client will be charged X amount for crossing B. if client pass first fence C, then fence B then client will be charged Y amount for crossing B.  There should facility to report history charges and purchases made to/by client.  On each charge customer should be notified via Notification Service.  Customer should be able to purchase credits using credit cards/pay pal account/debit cards  Android client should be able to read GPS signal for every X distance and sent to server.  Android client should be able to login into server using credentials passed by customer.  Only one account should be used in one device at a time. If the same account is used in another device, logout the first one.  Report should able to save it as .CSV file (comma separate values).  Web application should have API to login, send GPS location, and get last transaction information for client Android application to work.  Website should have facility to retrieve forgot password. Toll Application | Omnificence Page 8
  • 9.
    TOLL APPLICATION 2.3 SoftwareInterface Users Web browser (any), operating system (any) and Android operating system for Mobile application Administrator Web browser (any), operating system (Windows) Web Server IIS, Operating System (Windows) Data Base Server MS SQL Server 2008, operating system (Windows) Development End MS Visual studio 2005 2.4 Hardware Interface 2.4.1 Minimum Requirements Toll App (Server) Processor Storage Space RAM Disk Space Intel Core Family – 8 GB RAM 500 GB 1 GB RAM 8 GB AMD Athlon MS SQL Server 2008 Users (Public People) Android Processor RAM Android OS ARM V6 Processor 128 MB RAM (Version 2.2) Toll Application | Omnificence Page 9
  • 10.
    TOLL APPLICATION 2.4.2 RecommendedRequirements Toll App (Server) Processor Storage Space RAM Disk Space Intel Core Family (Any) 10 GB RAM 1 TB 2 GB RAM 10 GB – AMD Phenom MS SQL Server 2008 (Above 2 GHz) Users (Public People) Android Android OS Processor RAM ARM V7 Processor 300 MB RAM (in and above 2.2) 2.5 User Characteristics  Both users and administrator on internet will be using HTTP protocol.  User uses Android application for availing the Toll App service.  Administrator uses web application to manage the application service for their users. 2.6 Constraints  GUI is only in English.  Centralized server is used. 2.7 Assumptions and Dependencies Toll App mobile application can be installed only on Android OS (above v 2.2). It is assumed that the user has a GPS enabled device installed with Android OS. It is assumed that the user don’t switch off his device or close the application at any time. The web application needs Google Map API to create fences across states in USA. The Android application must use PayPal service to credit the balance. Toll Application | Omnificence Page 10
  • 11.
    TOLL APPLICATION 2.8 ArchitectureDesign Toll Application | Omnificence Page 11
  • 12.
    TOLL APPLICATION 2.9 UseCase Model Survey 2.9 Use Case Model Survey Android client  Android client can read GPS signal for every X distance and sent to server  Android client can login into server using credentials passed by customer. Toll Application | Omnificence Page 12
  • 13.
    TOLL APPLICATION Users  Users canpurchase credits using credit cards/pay pal account/debit cards.  Users can view his history about the payments made.  Users can receive notification about the charges when he crosses the fences that created in Google map. Administrator  Administrator can manage users like activating/deactivating accounts, set password for users, delete an account, and set application level settings like frequency of GPS signal to the server from client.  Administrator can create/edit/delete geo fences using Google map and it should be stored in database.  Administrator should able to set charge for a fence when client pass through it.  Administrator can generate report for history charges and purchases made to/by client. Web application  Web application has registration and login facility  Web application supports payment for users to pay for the application service.  Web application has API to login, send GPS location and get last transaction information for client Android application to work.  Web application has facility to retrieve forgot password. Database  Database (MS SQL Server 2008) keep track of all the records includes Location history, amount transactions.  Database also keeps the history of charges to the US peoples while they crossing the fences.  Database keeps the identity of the users (both personal and Car information) for the purpose of monitoring their travel. Toll Application | Omnificence Page 13
  • 14.
    TOLL APPLICATION 2.10 ERDiagram Toll Application | Omnificence Page 14
  • 15.
    TOLL APPLICATION 3. SpecificRequirements 3.1 Use Case Reports 3.1.1 Administrator 3.1.1 Use Case Report for Administrator USECASE Manage users Activate Deactivate Set password Set application settings Manage fences Create Edit Delete Fix charge Set dependent fence Generate report DESCRIPTION The administrator can manage users and their account The administrator can approve user after his registration The administrator can deactivate users The administrator can set password for users The administrator can change application settings The administrator can manage fences by using Google map The administrator can create a new fence The administrator can edit the existing fence The administrator can delete the existing fence The administrator can fix charge for each fence The administrator can set the dependent fence The administrator can generate reports for all transactions Toll Application | Omnificence Page 15
  • 16.
    TOLL APPLICATION 3.1.2 WebApplication (Server) 3.1.2 Use Case Report for Web application (Server) USECASE Push notification Charges GPS Location Read coordinates Support fence creation Validate Sign in Validate Registration Username check Keep location history DESCRIPTION The application can push notifications to users The application can send notification about charges The application can send notification about GPS Location The application can read coordinates from the android client The application supports the admin for creation The application can validate when the user signs in The application can validate user registration The application can check if the username exists already while registration The application can keep location history of the users Toll Application | Omnificence Page 16
  • 17.
    TOLL APPLICATION Access API Sendmail Detect users Support one login Payment support Manage transaction Purchase validation Balance management Add balance Remove balance Report History charges Credit purchases FAQ The application can use the API to access various resources The application can send mails to the users and admin The application can identify whether the logged user is normal user or administrator The application should force the user not to log in second time at an instance The application should support various payment methods The application should manage transaction The applications should validate the user purchases The application can manage the balance for the respective user The application can add balance to the account The application can remove balance when the user crosses a fence The application can generate reports on various transactions The application can generate reports on history charges The application can generate reports on credits purchases The application can maintain FAQ 3.1.3 Android client 3.1.3 Use Case Report for Android client Toll Application | Omnificence Page 17
  • 18.
    TOLL APPLICATION USECASE Connect toserver Do amount transactions Read GPS signal Send GPS signal Receive notification Charges GPS Location DESCRIPTION The client can connect to the server by using the login credentials The client can perform amount transaction The client can read its current location using GPS The client can send its current location using GPS The client can receive notifications about various information The client can receive notifications about the charges deducted The client can receive notifications about the current location using GPS 3.1.4 US People 3.1.4 Use Case Report for US People USECASE Register identities Pass credentials Purchase credits Amount transaction View notifications Retrieve password DESCRIPTION The people can register for his account The people can pass credentials while logging in The people can purchase credits by using his PayPal / Credit / Debit card The people can transfer amount while purchase credits The people can view notifications about various information The people can retrieve password if he forgets Toll Application | Omnificence Page 18
  • 19.
    TOLL APPLICATION 3.2 ActivityDiagrams 3.2.1 User Registration The user is made to fill all the mandatory fields, each user must choose a unique user name. If the user has filled a name that is already present in the database, then the user will be prompted to fill in a different username. After this the user must enter the new password and other identities. When the user submits the form it is validated and if the registration is successful the user’s profile is displayed else it will display the error. 3.2.1 User Registration Activity Toll Application | Omnificence Page 19
  • 20.
    TOLL APPLICATION 3.2.2 LoginActivity The user enters the login credentials. The System validates the login credentials. If the login credentials are valid then the system detects the type of user. If user is a member then the system redirects to the member’s home page. If the user is administrator then the system redirects to the administrator’s home page. 3.2.2 Login Activity Toll Application | Omnificence Page 20
  • 21.
    TOLL APPLICATION 3.2.3 Manageusers The administrator can go to account management interface to manage the users. He can activate newly registered users and he can deactivate users in case if necessary. The administrator can also set password for the users. 3.2.3 Manage users Toll Application | Omnificence Page 21
  • 22.
    TOLL APPLICATION 3.2.4 Managefences The administrator can manage the fences after login. He can view the existing fences he created. He can mark the new fence. Once he created a fence successfully he can set dependent fence. He can set fare for that particular fence. He can also edit the fences if necessary. 3.2.4 Manage fences Toll Application | Omnificence Page 22
  • 23.
    TOLL APPLICATION 3.2.5 Retrievepassword The user can retrieve his account if he forgets his password. He can request for password by providing his mail ID. If the mail ID exists in database then the password retrieving options are sent to his mail ID else he is prompted to enter he mail ID again. 3.2.5 Retrieve password Toll Application | Omnificence Page 23
  • 24.
    TOLL APPLICATION 3.2.6 SupportOne Login Toll App supports the user to login only once at an instance. The user enter the login credentials and request for login. If the user is not logged in previously in any other device then a new session is created else the previous session is closed and then a new session is created. 3.2.6 Support One Login Toll Application | Omnificence Page 24
  • 25.
    TOLL APPLICATION 3.3 SequenceDiagrams 3.3.1 User Registration 3.3.1 User Registration While registering the user should enter the username. The username is checked with the existing usernames from the database. If he enters a new username then he enters his identity. Then those identities are sent for registration. On successful registration the user is displayed his profile else he is shown the respective error. Toll Application | Omnificence Page 25
  • 26.
    TOLL APPLICATION 3.3.2 Androidclient 3.3.2 Android client In Android client the user should enter the login credentials for the first time. On successful login the user is shown his account else he is shown the respective error. After login he can pay the amount to purchase the credits. Once he purchased the credits, his location is updated in the server for a particular time interval. If his location is changed to a new location the amount is debited and the notification is sent to the user. Toll Application | Omnificence Page 26
  • 27.
    TOLL APPLICATION 3.3.3 AmountTransaction 3.3.3 Amount Transaction The User can pay the amount to buy credits using PayPal account. PayPal validates his credentials. On successful validation the user can add credits and the transaction is updated in the database. Notifications are sent to the users after the credits are added. Toll Application | Omnificence Page 27
  • 28.
    TOLL APPLICATION 3.3.4 RetrievePassword 3.3.4 Retrieve Password If the user forgets the password, he can request for password. The request is forwarded to the web application. The web application verifies if the username exists in the database. On successful verification the password resetting options are shown to the user. Toll Application | Omnificence Page 28
  • 29.
    TOLL APPLICATION 3.3.5 BalanceManagement 3.3.5 Balance Management The Android client sends the user’s co-ordinates to the web application. The web application validates if the user is in new co-ordinates. If the user is in new co-ordinates then the amount is debited and the transaction details are updated in the database. On successful transaction the notification is sent to the user. Toll Application | Omnificence Page 29
  • 30.
    TOLL APPLICATION Thanks to TollApplication | Omnificence Page 30
