C2PT Catalyst Process Technology

Gerard B. Hawkins
Managing Director, CEO


Role :- To advise and recommend on all
aspects pertaining to Catalyst Process
Technology (C2PT) selection and
implementation.



NOT TO MANAGE THE COMMISSIONING



Share experience gained from observations
of commissioning process
Client
Enquiry

GBH Enterprises, Ltd.
• Catalyst Volume
• Process Conditions
• Production Guarantee
Licensed Contractor
• Paid Study
• Flowsheet Heat & Mass Bal
• Layout
• Heat Integration
• Sanction Grade Estimate
• Project Guarantees
• Production Guarantee
• Efficiency
• Energy
• Feedstock
• Utility Consumption
Client
Enquiry
GBH Enterprises, Ltd.
• Catalyst Volume
• Process Conditions
• Production Guarantee

Licensed
Contractor
◦ Design
◦ Guarentees


Licensed Contractor
◦ Paid Study
 Flowsheet Heat & Mass Bal
 Layout
 Heat Integration

 Sanction Grade Estimate
 Project Guarantees






Production Guarantee
Efficiency
Energy
Feedstock
Utility Consumption


Detailed Engineering / Design
◦ Pipe work, vessels, layout etc
◦ Subcontract
 Procurement
 Materials, pumps, instruments
 Compressors, (10 - 15 M), vessels

 Construction


Commissioning
◦ Team on site
 Pre-commissioning
 Initial start up with client


Licensed Contractor
◦ Paid Study





·Equipment Selection
o Pumps - All types and sizes from fractional to
10,000hp
o Gas Turbines
o Steam Turbine Generators
o Cooling Towers
o Air Compressors from 100 to 10,000 scfm
o Boilers - Gas, Oil, and Coal-Fired
o Process Equipment - Heat Exchangers, Water
Treatment
o Scrubbers, Precipitators, Baghouse Chillers
· Equipment Layouts


Licensed Contractor
◦ Paid Study



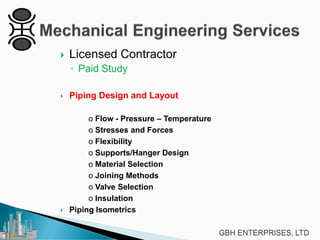

Piping Design and Layout



o Flow - Pressure – Temperature
o Stresses and Forces
o Flexibility
o Supports/Hanger Design
o Material Selection
o Joining Methods
o Valve Selection
o Insulation
Piping Isometrics


Licensed Contractor
◦ Paid Study



Process Design
o Skids
o Thermodynamic Cycles (steam-gas turbinediesel)
o Heating, Ventilating and Air Conditioning
o Cooling Systems
o Water Treatment
o Wastewater Treatment


Licensed Contractor
◦ Paid Study



System Design
o Steam - Water and Hot Gas Systems in support
of Steam and Gas Power Cycles
o Combustion Air and Flue (Exhaust) Gas
o Fuels - Natural Gas - Light and Heavy Oil - Coal
– Lignite
o Fire Protection
o Water Distribution
o Wastewater Sewerage
o Chemical Processes
o Lube Oil
o Gasses


Licensed Contractor
◦ Paid Study



Material Handling Design
o Bulk Solids (coal, limestone, and dry chemicals)
o Wet Conveying of Solids (slurries)
o Air Conveying of Solids (vacuum and
pressurized)
o Rail Loading and Off-Loading Facilities


Licensed Contractor
◦ Paid Study



o

o

o
o

o
o

o

Electrical Engineering Services
Specification and Design of Complete Electric
Systems
Electrical Generating Plants - Steam, Diesel,
Combustion Turbine
Transmission Systems - 69 to 345 kV
Substations – Power Generation, Stepdown,
Transmission
Electrical Distribution
Switching & Power Station Distribution Facilities
and Systems
Emergency Electrical Power


Licensed Contractor
◦ Paid Study



o
o
o
o
o
o
o
o

o
o

Electrical Engineering Services
Emergency Electrical Power
Supervisory Control and Data Acquisition
AC and DC Auxiliary Systems
Load Flow Analysis
Fault and Short Circuit Studies
Motor Starting Studies
Lightning Protection
Protective Relay Selection - Application –
Coordination
Circuit Breaker / Fuse Trip Setting – Coordination
Hazardous and Non-Hazardous Area Design


Licensed Contractor
◦ Paid Study



Electrical Engineering Services

o

Lighting Systems
Communication Systems
Fire Detection Systems
Alarm Systems
Energy Analysis
Feasibility Studies
Rate Studies

o
o
o
o
o
o


Licensed Contractor
◦ Paid Study





Instrumentation & Control Engineering
Instrument Systems Design
o Flow Meter Engineering
o Control Valve Selection and Sizing
o Instrument Specification and Procurement
o Burner and Boiler Controls
o Process Control Systems
o Materials Handling Systems
o Analytical Instrumentation and Sampling
Systems


Licensed Contractor
◦ Paid Study



Instrumentation & Control Engineering



Control Panel & Cabinet Design
o Microstation, Intergraph, and AutoCad capable
o Panel & Cabinet Layouts
o Wiring Diagrams
o Termination Layouts
o Interconnect Diagrams
Instrument Installation
o Loop Sheets
o Instrument Location Drawings
o Cable Schedules
o Installation Details & Practices




Licensed Contractor
◦ Paid Study



Instrumentation & Control Engineering



Control Systems Engineering
o Batch Programming per ISA S88
o Continuous Process Control
o Logic Diagrams
o Logic Narratives
o SAMA Diagrams
DCS Systems Design and Implementation
PLC Systems Design and Programming
HMI System Design and Programming
Checkout, Startup, & Tuning Services Available







Licensed Contractor
◦ Paid Study



Civil / Structural / Architectural



Industrial Steel Design
Foundation Design
Site Development
Architectural Building Development
Geotechnical Review
Piling Design
Machinery Foundation Vibration Analysis
Reinforced Concrete Design
Subgrade and Pavement Design











Licensed Contractor
◦ Paid Study



Civil / Structural / Architectural



Lime and Cement Stabilization Design
Structural Design
Structural Frame Analysis
Site Selection Studies
Railroad Route Selection and Design
Hydrological Studies
Culvert and Drainage Analysis and Design
Pipeline Routing and Design
Concrete and Steel Tank Design
Sanitary Sewer and Storm Sewer Design












Licensed Contractor
◦ Paid Study



Chemical Engineering



Water and Wastewater Treatment
o Clarification
o Lime and Lime/Soda Softening
o Filtration
o Reverse Osmosis and Ultrafiltration
o Ion Exchange
o Sedimentation
o Flow Equalization


Licensed Contractor
◦ Paid Study



Chemical Engineering



Water and Wastewater Treatment
o Chemical
o Conditioning Heavy Metal Removal
o Piping systems, piperack, underground, steel,
stainless, nonmetallic
o Pump selection and systems
o System controls
o Tanks
o Ponds, Lagoons


Licensed Contractor
◦ Paid Study



Chemical Engineering



Water and Wastewater Treatment



Particulate Removal
Sulfur Dioxide Reduction
Solid Waste Disposal
Environmental Monitoring






Licensed Contractor
◦ Paid Study



Project Development & Controls



Feasibility Study
P & ID Development
General Facility Layout
Project Schedule
Budget Estimate
Project Scope






