Setting out of Engineering works
Faculty of Civil Engineering FUT
Minna
CIE321
YOUR SITE
28th June 2024 Site Setting-out 2
Or This
28th June 2024 Site Setting-out 3
28th June 2024 Site Setting-out 4

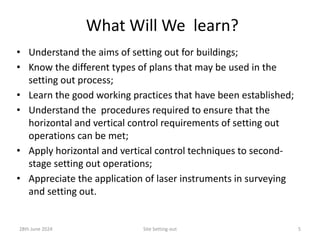

What Will We learn?
• Understand the aims of setting out for buildings;
• Know the different types of plans that may be used in the
setting out process;
• Learn the good working practices that have been established;
• Understand the procedures required to ensure that the
horizontal and vertical control requirements of setting out
operations can be met;
• Apply horizontal and vertical control techniques to second-
stage setting out operations;
• Appreciate the application of laser instruments in surveying
and setting out.
28th June 2024 Site Setting-out 5

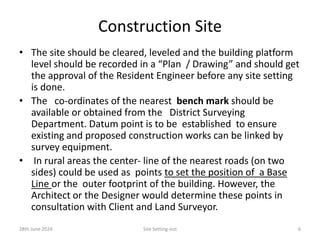

Construction Site
• The site should be cleared, leveled and the building platform
level should be recorded in a “Plan / Drawing” and should get
the approval of the Resident Engineer before any site setting
is done.
• The co-ordinates of the nearest bench mark should be
available or obtained from the District Surveying
Department. Datum point is to be established to ensure
existing and proposed construction works can be linked by
survey equipment.
• In rural areas the center- line of the nearest roads (on two
sides) could be used as points to set the position of a Base
Line or the outer footprint of the building. However, the
Architect or the Designer would determine these points in
consultation with Client and Land Surveyor.
28th June 2024 Site Setting-out 6

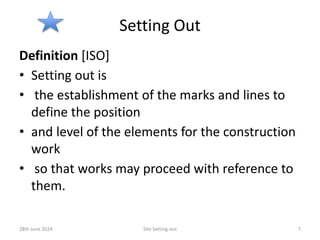

Setting Out
Definition [ISO]
• Setting out is
• the establishment of the marks and lines to
define the position
• and level of the elements for the construction
work
• so that works may proceed with reference to
them.
28th June 2024 Site Setting-out 7

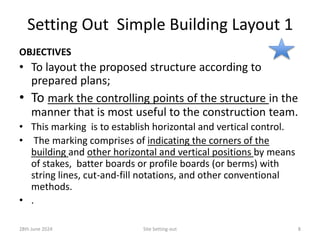

Setting Out Simple Building Layout 1
OBJECTIVES
• To layout the proposed structure according to
prepared plans;
• To mark the controlling points of the structure in the
manner that is most useful to the construction team.
• This marking is to establish horizontal and vertical control.
• The marking comprises of indicating the corners of the
building and other horizontal and vertical positions by means
of stakes, batter boards or profile boards (or berms) with
string lines, cut-and-fill notations, and other conventional
methods.
• .
28th June 2024 Site Setting-out 8
Setting Out Simple Building Layout 2
• Thus, Setting Out is positioning the base of the
intended construction facility on ground, in relation
to the other facilities in the construction area.
• Setting out should be done with surveying
equipment which fall within valid calibration period.
• Setting out is an ongoing process; Cross-checks to
already constructed work should be carried out
regularly.
28th June 2024 Site Setting-out 9

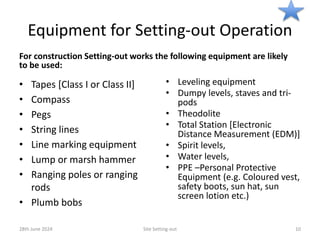

Equipment for Setting-out Operation
For construction Setting-out works the following equipment are likely
to be used:
• Tapes [Class I or Class II]
• Compass
• Pegs
• String lines
• Line marking equipment
• Lump or marsh hammer
• Ranging poles or ranging
rods
• Plumb bobs
• Leveling equipment
• Dumpy levels, staves and tri-
pods
• Theodolite
• Total Station [Electronic
Distance Measurement (EDM)]
• Spirit levels,
• Water levels,
• PPE –Personal Protective
Equipment (e.g. Coloured vest,
safety boots, sun hat, sun
screen lotion etc.)
28th June 2024 Site Setting-out 10

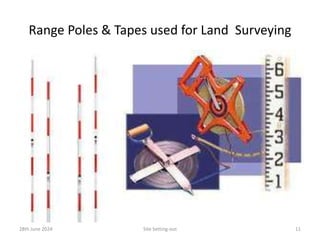

Range Poles & Tapes used for Land Surveying
28th June 2024 Site Setting-out 11

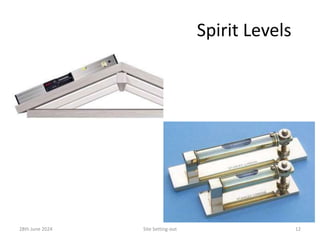

Spirit Levels
28th June 2024 Site Setting-out 12

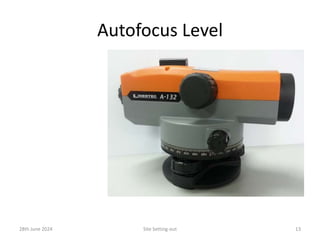

Autofocus Level
28th June 2024 Site Setting-out 13

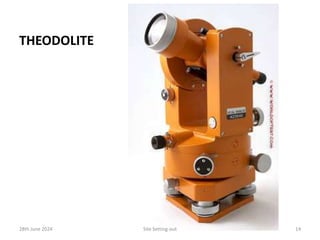

THEODOLITE
28th June 2024 Site Setting-out 14
Total Station
28th June 2024 Site Setting-out 15

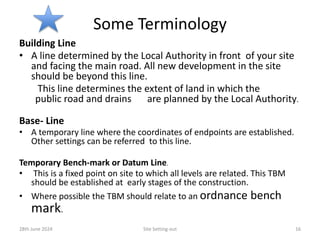

Some Terminology
Building Line
• A line determined by the Local Authority in front of your site
and facing the main road. All new development in the site
should be beyond this line.
This line determines the extent of land in which the
public road and drains are planned by the Local Authority.
Base- Line
• A temporary line where the coordinates of endpoints are established.
Other settings can be referred to this line.
Temporary Bench-mark or Datum Line.
• This is a fixed point on site to which all levels are related. This TBM
should be established at early stages of the construction.
• Where possible the TBM should relate to an ordnance bench
mark.
28th June 2024 Site Setting-out 16
Modern Surveying Equipment
7/27/2024 Site Setting-out 17
7/27/2024 Site Setting-out 18

Establishing Datum
Datum
Could be our own Datum - Assumed Datum
- Arbitrary Datum
- Site Datum
Or
A National Datum
In the Malaysia they have a national organisation known as
Jabatan Ukur dan Pemetaan Malaysia (JUPEM)
- Ordnance Datum
A D
O D
Based on the Ordnance Datum - points of known height above
or below Zero height have been established around the Malaysia
These points around the country are known as Bench Marks
Above Assumed Datum A A D
Above Ordnance Datum A O D

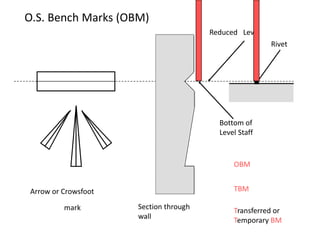

O.S. Bench Marks (OBM)
Arrow or Crowsfoot
mark
Reduced Level
Section through
wall
Rivet
Bottom of
Level Staff
OBM
TBM
Transferred or
Temporary BM

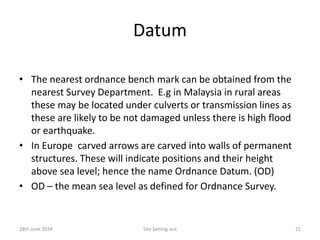

Datum
• The nearest ordnance bench mark can be obtained from the
nearest Survey Department. E.g in Malaysia in rural areas
these may be located under culverts or transmission lines as
these are likely to be not damaged unless there is high flood
or earthquake.
• In Europe carved arrows are carved into walls of permanent
structures. These will indicate positions and their height
above sea level; hence the name Ordnance Datum. (OD)
• OD – the mean sea level as defined for Ordnance Survey.
28th June 2024 Site Setting-out 21

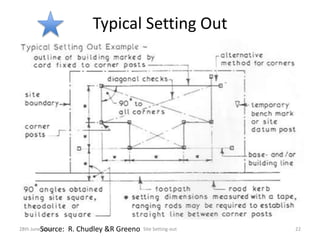

Typical Setting Out
28th June 2024 Site Setting-out 22
Source: R. Chudley &R Greeno

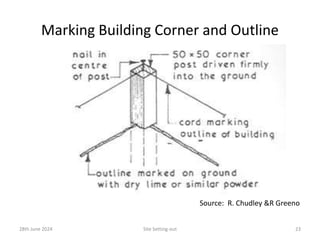

Marking Building Corner and Outline
28th June 2024 Site Setting-out 23
Source: R. Chudley &R Greeno
• .
NOTE:
Pegs are driven first
Profile Boards are
nailed after checking
for horizontal position
with spirit levels,
Position of trench width
established. Nails to
stretch strings are then
hammered.
Wall width could be
painted.
28th June 2024 Site Setting-out 24

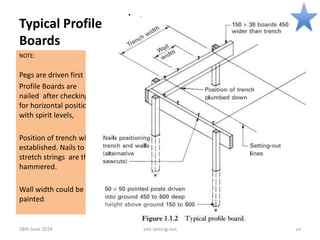

Typical Profile
Boards

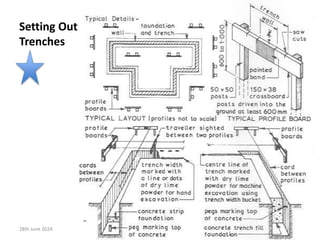

Setting Out
Trenches
28th June 2024 Site Setting-out 25
.
28th June 2024 Site Setting-out 26
28th June 2024 Site Setting-out 27
Setting Out Trenches
Objectives
• To establish the excavation size, shape and direction;
• To establish the width and position of the walls;
• To establish the depth at various positions as required by design.
• After establishing the building outline, fix Profile Boards at least
2.0m clear of trench positions so that, they do not obstruct
excavations to follow. See Fig.
• The levels of the profile cross boards should be related to the site
datum and fixed at a suitable height above ground. This is to
enable check depths of trench at various positions using a traveller.
• Otherwise the trench depth can be controlled using a level and
staff related to site datum.
• The trench width can be marked on the profile board with either
nails, or saw cuts or or painted band if required for identification.
28th June 2024 Site Setting-out 28

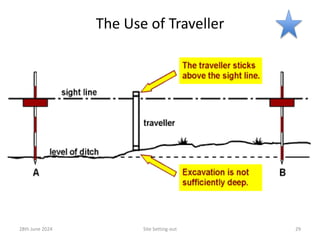

The Use of Traveller
28th June 2024 Site Setting-out 29
Setting Out for Strip Foundation
28th June 2024 Site Setting-out 30
28th June 2024 Site Setting-out 31
or Traveller

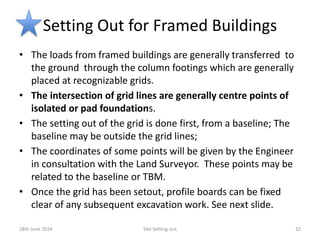

Setting Out for Framed Buildings
• The loads from framed buildings are generally transferred to
the ground through the column footings which are generally
placed at recognizable grids.
• The intersection of grid lines are generally centre points of
isolated or pad foundations.
• The setting out of the grid is done first, from a baseline; The
baseline may be outside the grid lines;
• The coordinates of some points will be given by the Engineer
in consultation with the Land Surveyor. These points may be
related to the baseline or TBM.
• Once the grid has been setout, profile boards can be fixed
clear of any subsequent excavation work. See next slide.
28th June 2024 Site Setting-out 32

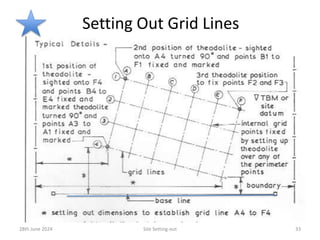

Setting Out Grid Lines
28th June 2024 Site Setting-out 33

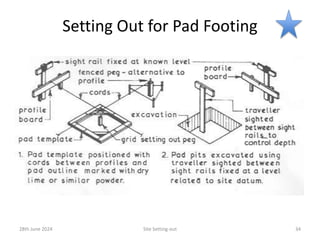

Setting Out for Pad Footing
28th June 2024 Site Setting-out 34
28th June 2024 Site Setting-out 35

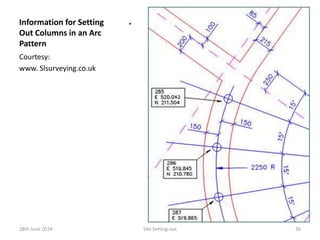

Information for Setting
Out Columns in an Arc
Pattern
.
Courtesy:
www. Slsurveying.co.uk
28th June 2024 Site Setting-out 36
28th June 2024 Site Setting-out 37
28th June 2024 Site Setting-out 38

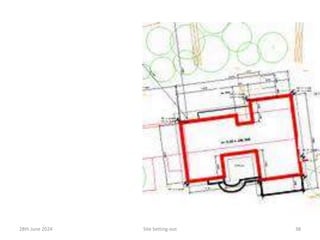

28th June 2024 Site Setting-out 39

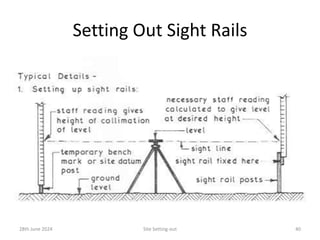

Setting Out Sight Rails

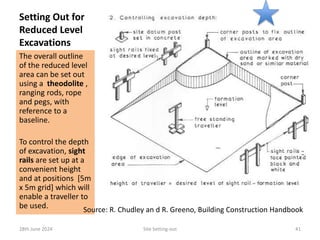

28th June 2024 Site Setting-out 40
Setting Out for
Reduced Level
Excavations
.
The overall outline
of the reduced level
area can be set out
using a theodolite ,
ranging rods, rope
and pegs, with
reference to a
baseline.
To control the depth
of excavation, sight
rails are set up at a
convenient height
and at positions [5m
x 5m grid] which will
enable a traveller to
be used.
28th June 2024 Site Setting-out 41
Source: R. Chudley an d R. Greeno, Building Construction Handbook

Setting Out for Road works in Residential Areas
• Temporary roads: these may be gravelled
roads, in new residential development areas.
• Generally the centre-line or median of the road
is set out initially so that the location of storm
water drains can be identified and the building
line too can be located.
• The layout of the road could include straight
lengths , junctions, hammer heads, turning
bays and intersecting curves.
28th June 2024 Site Setting-out 42

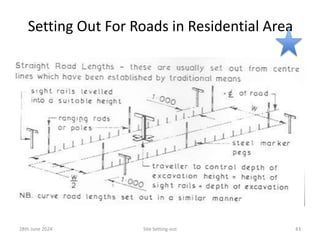

Setting Out For Roads in Residential Area
28th June 2024 Site Setting-out 43

Setting Out
For Roads
• Hammer Head
28th June 2024 Site Setting-out 44

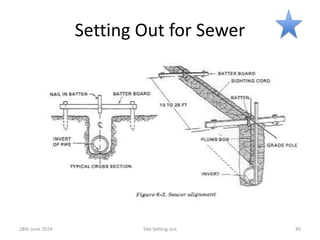

Setting Out for Sewer
28th June 2024 Site Setting-out 45

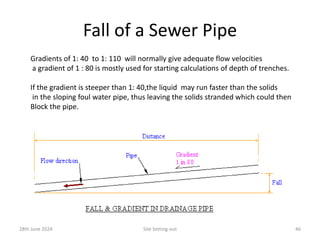

Fall of a Sewer Pipe
28th June 2024 Site Setting-out 46
Gradients of 1: 40 to 1: 110 will normally give adequate flow velocities
a gradient of 1 : 80 is mostly used for starting calculations of depth of trenches.
If the gradient is steeper than 1: 40,the liquid may run faster than the solids
in the sloping foul water pipe, thus leaving the solids stranded which could then
Block the pipe.

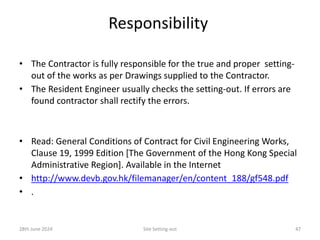

Responsibility
• The Contractor is fully responsible for the true and proper setting-
out of the works as per Drawings supplied to the Contractor.
• The Resident Engineer usually checks the setting-out. If errors are
found contractor shall rectify the errors.
• Read: General Conditions of Contract for Civil Engineering Works,
Clause 19, 1999 Edition [The Government of the Hong Kong Special
Administrative Region]. Available in the Internet
• http://www.devb.gov.hk/filemanager/en/content_188/gf548.pdf
• .
28th June 2024 Site Setting-out 47

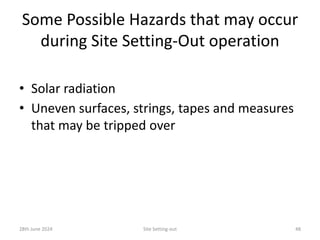

Some Possible Hazards that may occur
during Site Setting-Out operation
• Solar radiation
• Uneven surfaces, strings, tapes and measures
that may be tripped over
28th June 2024 Site Setting-out 48

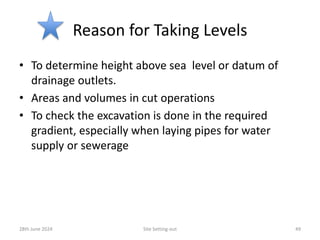

Reason for Taking Levels
• To determine height above sea level or datum of
drainage outlets.
• Areas and volumes in cut operations
• To check the excavation is done in the required
gradient, especially when laying pipes for water
supply or sewerage
28th June 2024 Site Setting-out 49
7/27/2024 Site Setting-out 50
7/27/2024 Site Setting-out 51

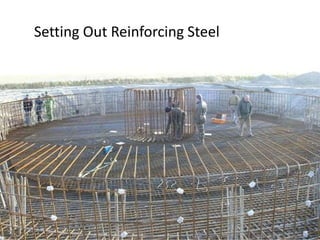

Setting Out Reinforcing Steel
References
1. Roy Chudley & Roger Greeno, Building Construction Handbook, Routledge, ,
NY, 2014.
2. Module 8 –Surveying and Setting-Out :
http://www.ilo.org/public/english/employment/recon/eiip/download/surve
y_setout.pdf [This is for Road Survey & Construction]
3. RTF3217A , Set-out site for construction works, Industry Skills Councils, May
2012. Department of Education, Employment and Workplace Relations,
Australia. Release 1.
4. ISO 7078: 1985 (2012 Review), Building Construction – procedures for
setting out, measurement and surveying –Vocabulary and Guidance Notes.
5. Jack Stroud Foster & Raymond Harington; Structure and Fabric Part 2, 5th
edition, Longman, 1996 Reprint.
6. M.J. Tomlinson, Foundation Design & Construction, 6th ed., Longman 1995.
7. The Institution of Civil Engineers,, UK :ICE Design Practice Guidelines: The
Management of Setting Out IN Construction, Thgomas Telford Publication,
1997
Site Setting-out 52
28th June 2024
Acknowledgement
• Che Ros Ismail – Road Construction, OCWUTM CRI2011,
(SAB2832 – Highway
Engineering)http://ocw.utm.my/file.php/3/notes/OCW_road_
construction.pdf
• Intoduction to Levelling :
www.htp.usm.my/hilmy%2520to%2520levelling%2520-
25201.ppt
Site Setting-out 53
28th June 2024

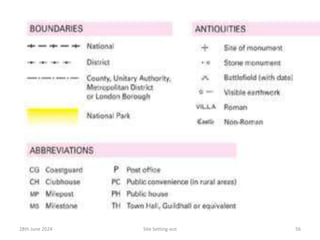

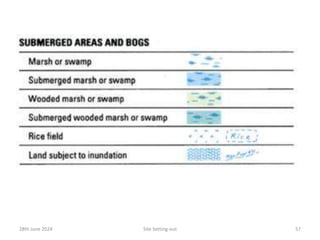

Survey Symbols
28th June 2024 Site Setting-out 54
28th June 2024 Site Setting-out 55
28th June 2024 Site Setting-out 56
28th June 2024 Site Setting-out 57
28th June 2024 Site Setting-out 58
28th June 2024 Site Setting-out 59
28th June 2024 Site Setting-out 60
7/27/2024 Site Setting-out 61

Site Setting Out presentation slide .PPTX

  • 1.
    Setting out ofEngineering works Faculty of Civil Engineering FUT Minna CIE321
  • 2.
    YOUR SITE 28th June2024 Site Setting-out 2
  • 3.
    Or This 28th June2024 Site Setting-out 3
  • 4.
    28th June 2024Site Setting-out 4
  • 5.
    What Will Welearn? • Understand the aims of setting out for buildings; • Know the different types of plans that may be used in the setting out process; • Learn the good working practices that have been established; • Understand the procedures required to ensure that the horizontal and vertical control requirements of setting out operations can be met; • Apply horizontal and vertical control techniques to second- stage setting out operations; • Appreciate the application of laser instruments in surveying and setting out. 28th June 2024 Site Setting-out 5
  • 6.
    Construction Site • Thesite should be cleared, leveled and the building platform level should be recorded in a “Plan / Drawing” and should get the approval of the Resident Engineer before any site setting is done. • The co-ordinates of the nearest bench mark should be available or obtained from the District Surveying Department. Datum point is to be established to ensure existing and proposed construction works can be linked by survey equipment. • In rural areas the center- line of the nearest roads (on two sides) could be used as points to set the position of a Base Line or the outer footprint of the building. However, the Architect or the Designer would determine these points in consultation with Client and Land Surveyor. 28th June 2024 Site Setting-out 6
  • 7.
    Setting Out Definition [ISO] •Setting out is • the establishment of the marks and lines to define the position • and level of the elements for the construction work • so that works may proceed with reference to them. 28th June 2024 Site Setting-out 7
  • 8.
    Setting Out SimpleBuilding Layout 1 OBJECTIVES • To layout the proposed structure according to prepared plans; • To mark the controlling points of the structure in the manner that is most useful to the construction team. • This marking is to establish horizontal and vertical control. • The marking comprises of indicating the corners of the building and other horizontal and vertical positions by means of stakes, batter boards or profile boards (or berms) with string lines, cut-and-fill notations, and other conventional methods. • . 28th June 2024 Site Setting-out 8
  • 9.
    Setting Out SimpleBuilding Layout 2 • Thus, Setting Out is positioning the base of the intended construction facility on ground, in relation to the other facilities in the construction area. • Setting out should be done with surveying equipment which fall within valid calibration period. • Setting out is an ongoing process; Cross-checks to already constructed work should be carried out regularly. 28th June 2024 Site Setting-out 9
  • 10.
    Equipment for Setting-outOperation For construction Setting-out works the following equipment are likely to be used: • Tapes [Class I or Class II] • Compass • Pegs • String lines • Line marking equipment • Lump or marsh hammer • Ranging poles or ranging rods • Plumb bobs • Leveling equipment • Dumpy levels, staves and tri- pods • Theodolite • Total Station [Electronic Distance Measurement (EDM)] • Spirit levels, • Water levels, • PPE –Personal Protective Equipment (e.g. Coloured vest, safety boots, sun hat, sun screen lotion etc.) 28th June 2024 Site Setting-out 10
  • 11.
    Range Poles &Tapes used for Land Surveying 28th June 2024 Site Setting-out 11
  • 12.
    Spirit Levels 28th June2024 Site Setting-out 12
  • 13.
    Autofocus Level 28th June2024 Site Setting-out 13
  • 14.
    THEODOLITE 28th June 2024Site Setting-out 14
  • 15.
    Total Station 28th June2024 Site Setting-out 15
  • 16.
    Some Terminology Building Line •A line determined by the Local Authority in front of your site and facing the main road. All new development in the site should be beyond this line. This line determines the extent of land in which the public road and drains are planned by the Local Authority. Base- Line • A temporary line where the coordinates of endpoints are established. Other settings can be referred to this line. Temporary Bench-mark or Datum Line. • This is a fixed point on site to which all levels are related. This TBM should be established at early stages of the construction. • Where possible the TBM should relate to an ordnance bench mark. 28th June 2024 Site Setting-out 16
  • 17.
  • 18.
    7/27/2024 Site Setting-out18 Establishing Datum
  • 19.
    Datum Could be ourown Datum - Assumed Datum - Arbitrary Datum - Site Datum Or A National Datum In the Malaysia they have a national organisation known as Jabatan Ukur dan Pemetaan Malaysia (JUPEM) - Ordnance Datum A D O D Based on the Ordnance Datum - points of known height above or below Zero height have been established around the Malaysia These points around the country are known as Bench Marks Above Assumed Datum A A D Above Ordnance Datum A O D
  • 20.
    O.S. Bench Marks(OBM) Arrow or Crowsfoot mark Reduced Level Section through wall Rivet Bottom of Level Staff OBM TBM Transferred or Temporary BM
  • 21.
    Datum • The nearestordnance bench mark can be obtained from the nearest Survey Department. E.g in Malaysia in rural areas these may be located under culverts or transmission lines as these are likely to be not damaged unless there is high flood or earthquake. • In Europe carved arrows are carved into walls of permanent structures. These will indicate positions and their height above sea level; hence the name Ordnance Datum. (OD) • OD – the mean sea level as defined for Ordnance Survey. 28th June 2024 Site Setting-out 21
  • 22.
    Typical Setting Out 28thJune 2024 Site Setting-out 22 Source: R. Chudley &R Greeno
  • 23.
    Marking Building Cornerand Outline 28th June 2024 Site Setting-out 23 Source: R. Chudley &R Greeno
  • 24.
    • . NOTE: Pegs aredriven first Profile Boards are nailed after checking for horizontal position with spirit levels, Position of trench width established. Nails to stretch strings are then hammered. Wall width could be painted. 28th June 2024 Site Setting-out 24 Typical Profile Boards
  • 25.
    Setting Out Trenches 28th June2024 Site Setting-out 25
  • 26.
    . 28th June 2024Site Setting-out 26

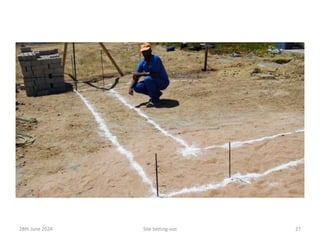

  • 27.
    28th June 2024Site Setting-out 27
  • 28.
    Setting Out Trenches Objectives •To establish the excavation size, shape and direction; • To establish the width and position of the walls; • To establish the depth at various positions as required by design. • After establishing the building outline, fix Profile Boards at least 2.0m clear of trench positions so that, they do not obstruct excavations to follow. See Fig. • The levels of the profile cross boards should be related to the site datum and fixed at a suitable height above ground. This is to enable check depths of trench at various positions using a traveller. • Otherwise the trench depth can be controlled using a level and staff related to site datum. • The trench width can be marked on the profile board with either nails, or saw cuts or or painted band if required for identification. 28th June 2024 Site Setting-out 28
  • 29.
    The Use ofTraveller 28th June 2024 Site Setting-out 29
  • 30.
    Setting Out forStrip Foundation 28th June 2024 Site Setting-out 30

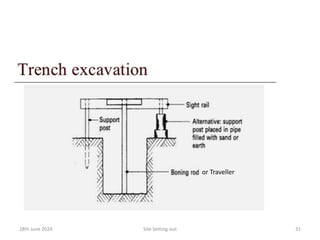

  • 31.
    28th June 2024Site Setting-out 31 or Traveller
  • 32.
    Setting Out forFramed Buildings • The loads from framed buildings are generally transferred to the ground through the column footings which are generally placed at recognizable grids. • The intersection of grid lines are generally centre points of isolated or pad foundations. • The setting out of the grid is done first, from a baseline; The baseline may be outside the grid lines; • The coordinates of some points will be given by the Engineer in consultation with the Land Surveyor. These points may be related to the baseline or TBM. • Once the grid has been setout, profile boards can be fixed clear of any subsequent excavation work. See next slide. 28th June 2024 Site Setting-out 32
  • 33.
    Setting Out GridLines 28th June 2024 Site Setting-out 33
  • 34.
    Setting Out forPad Footing 28th June 2024 Site Setting-out 34
  • 35.

    28th June 2024Site Setting-out 35
  • 36.
    Information for Setting OutColumns in an Arc Pattern . Courtesy: www. Slsurveying.co.uk 28th June 2024 Site Setting-out 36
  • 37.
    28th June 2024Site Setting-out 37
  • 38.
    28th June 2024Site Setting-out 38
  • 39.

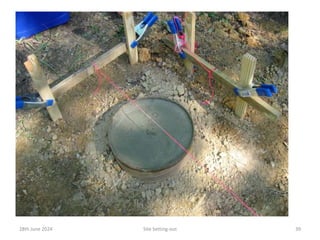

    28th June 2024Site Setting-out 39
  • 40.
    Setting Out SightRails 28th June 2024 Site Setting-out 40
  • 41.
    Setting Out for ReducedLevel Excavations . The overall outline of the reduced level area can be set out using a theodolite , ranging rods, rope and pegs, with reference to a baseline. To control the depth of excavation, sight rails are set up at a convenient height and at positions [5m x 5m grid] which will enable a traveller to be used. 28th June 2024 Site Setting-out 41 Source: R. Chudley an d R. Greeno, Building Construction Handbook
  • 42.
    Setting Out forRoad works in Residential Areas • Temporary roads: these may be gravelled roads, in new residential development areas. • Generally the centre-line or median of the road is set out initially so that the location of storm water drains can be identified and the building line too can be located. • The layout of the road could include straight lengths , junctions, hammer heads, turning bays and intersecting curves. 28th June 2024 Site Setting-out 42
  • 43.
    Setting Out ForRoads in Residential Area 28th June 2024 Site Setting-out 43
  • 44.
    Setting Out For Roads •Hammer Head 28th June 2024 Site Setting-out 44
  • 45.
    Setting Out forSewer 28th June 2024 Site Setting-out 45
  • 46.
    Fall of aSewer Pipe 28th June 2024 Site Setting-out 46 Gradients of 1: 40 to 1: 110 will normally give adequate flow velocities a gradient of 1 : 80 is mostly used for starting calculations of depth of trenches. If the gradient is steeper than 1: 40,the liquid may run faster than the solids in the sloping foul water pipe, thus leaving the solids stranded which could then Block the pipe.
  • 47.
    Responsibility • The Contractoris fully responsible for the true and proper setting- out of the works as per Drawings supplied to the Contractor. • The Resident Engineer usually checks the setting-out. If errors are found contractor shall rectify the errors. • Read: General Conditions of Contract for Civil Engineering Works, Clause 19, 1999 Edition [The Government of the Hong Kong Special Administrative Region]. Available in the Internet • http://www.devb.gov.hk/filemanager/en/content_188/gf548.pdf • . 28th June 2024 Site Setting-out 47
  • 48.
    Some Possible Hazardsthat may occur during Site Setting-Out operation • Solar radiation • Uneven surfaces, strings, tapes and measures that may be tripped over 28th June 2024 Site Setting-out 48
  • 49.
    Reason for TakingLevels • To determine height above sea level or datum of drainage outlets. • Areas and volumes in cut operations • To check the excavation is done in the required gradient, especially when laying pipes for water supply or sewerage 28th June 2024 Site Setting-out 49
  • 50.
  • 51.
    7/27/2024 Site Setting-out51 Setting Out Reinforcing Steel
  • 52.
    References 1. Roy Chudley& Roger Greeno, Building Construction Handbook, Routledge, , NY, 2014. 2. Module 8 –Surveying and Setting-Out : http://www.ilo.org/public/english/employment/recon/eiip/download/surve y_setout.pdf [This is for Road Survey & Construction] 3. RTF3217A , Set-out site for construction works, Industry Skills Councils, May 2012. Department of Education, Employment and Workplace Relations, Australia. Release 1. 4. ISO 7078: 1985 (2012 Review), Building Construction – procedures for setting out, measurement and surveying –Vocabulary and Guidance Notes. 5. Jack Stroud Foster & Raymond Harington; Structure and Fabric Part 2, 5th edition, Longman, 1996 Reprint. 6. M.J. Tomlinson, Foundation Design & Construction, 6th ed., Longman 1995. 7. The Institution of Civil Engineers,, UK :ICE Design Practice Guidelines: The Management of Setting Out IN Construction, Thgomas Telford Publication, 1997 Site Setting-out 52 28th June 2024
  • 53.
    Acknowledgement • Che RosIsmail – Road Construction, OCWUTM CRI2011, (SAB2832 – Highway Engineering)http://ocw.utm.my/file.php/3/notes/OCW_road_ construction.pdf • Intoduction to Levelling : www.htp.usm.my/hilmy%2520to%2520levelling%2520- 25201.ppt Site Setting-out 53 28th June 2024
  • 54.
    Survey Symbols 28th June2024 Site Setting-out 54
  • 55.
    28th June 2024Site Setting-out 55
  • 56.
    28th June 2024Site Setting-out 56
  • 57.
    28th June 2024Site Setting-out 57
  • 58.
    28th June 2024Site Setting-out 58
  • 59.
    28th June 2024Site Setting-out 59
  • 60.
    28th June 2024Site Setting-out 60
  • 61.

Editor's Notes

  • #23 NOTE: 1. Right Temporary Bench Mark 2. Front Bottom - Road Ker and Footpath 3. Left - Site Boundary 4 - Base / Building Line 5. Outline of Building
  • #24 NOTE 1 – Outline marked on ground with lime or chalk 2. Nail in center of peg
  • #26 NOTE: Drive all necessary posts to establish position of trenches with profile boards. 2. mark center line of trench with dry lime for machine trenching. 3. mark trench width with lime for hand digging.
  • #34  Note 1. Site Boundary 2. TBM on the right. 3. Establish Base Line See bottom. 4. First position is F4. 5. Mark positions B4, C4,D4 and E4 and then A4. 6. Turn theodolite at 90 degree. Establish A3 to A 1. and mark on ground. 7. Position theodolite at A4. 8. Establish positions B1 to F1 and mark. 9. Position theodolite at F1. Establish positions F2 and F3.. 10. Establish other other internal grid points.
  • #35 NOTE 1. Establish center points. 2. Fix profile boards as necessary on sides at right angles. 3. Mark positions of pad footing on profile boards. 4. Make pad template. 5. Position pad template to align with cords between profile boards . Mark pad outline with dry lime. 6. Remove pad template. 7. Excavate pad pits using traveller .
