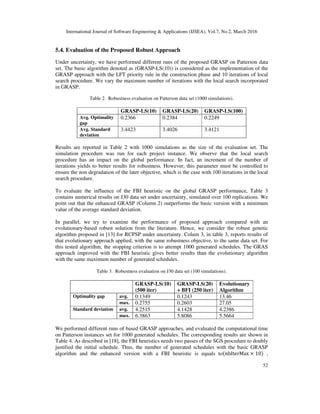

This document discusses an enhanced GRASP approach to optimize the robustness of the Resource-Constrained Project Scheduling Problem (RCPSP) under activity duration uncertainty. The authors focus on minimizing the worst-case performance (min-max robustness) through a scenario-based model and computational experiments on two benchmark data sets demonstrate that their proposed method outperforms existing algorithms. The paper introduces key concepts related to robust scheduling, outlines the methodology, and presents detailed findings on the effectiveness of the approach.
