Dr Deepak Kumar Tripathi
Environmental Expert
ENVIRONMENTAL
SAFEGUARD

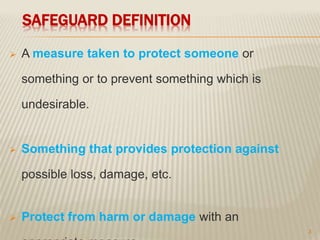

SAFEGUARD DEFINITION
 A measure taken to protect someone or
something or to prevent something which is
undesirable.
 Something that provides protection against
possible loss, damage, etc.
 Protect from harm or damage with an
3

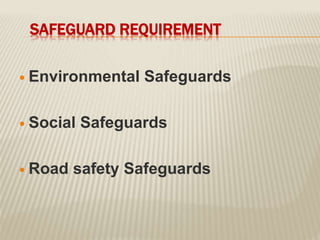

SAFEGUARD REQUIREMENT
 Environmental Safeguards
 Social Safeguards
 Road safety Safeguards

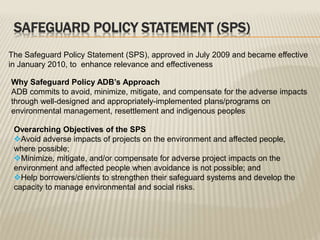

SAFEGUARD POLICY STATEMENT (SPS)
The Safeguard Policy Statement (SPS), approved in July 2009 and became effective
in January 2010, to enhance relevance and effectiveness
Why Safeguard Policy ADB’s Approach
ADB commits to avoid, minimize, mitigate, and compensate for the adverse impacts
through well-designed and appropriately-implemented plans/programs on
environmental management, resettlement and indigenous peoples
Overarching Objectives of the SPS
Avoid adverse impacts of projects on the environment and affected people,
where possible;
Minimize, mitigate, and/or compensate for adverse project impacts on the
environment and affected people when avoidance is not possible; and
Help borrowers/clients to strengthen their safeguard systems and develop the
capacity to manage environmental and social risks.

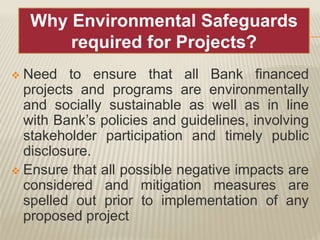

 Need to ensure that all Bank financed
projects and programs are environmentally
and socially sustainable as well as in line
with Bank’s policies and guidelines, involving
stakeholder participation and timely public
disclosure.
 Ensure that all possible negative impacts are
considered and mitigation measures are
spelled out prior to implementation of any
proposed project
Why Environmental Safeguards

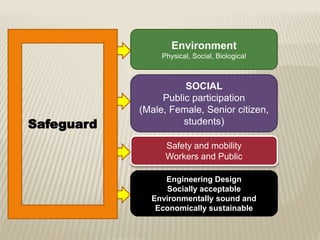

required for Projects?
SOCIAL
Public participation
(Male, Female, Senior citizen,
students)
Environment
Physical, Social, Biological
Safety and mobility
Workers and Public
Engineering Design
Socially acceptable
Environmentally sound and
Economically sustainable
Safeguard
ENVIRONMENTAL PROJECT CATEGORY
Proposed projects are screened according to type, location, scale, and sensitivity
and
the magnitude of their potential environmental impacts, including direct, indirect,
induced, and cumulative impacts. Projects are classified into the following four
categories:
 Category A. A proposed project is likely to have significant adverse
environmental impacts that are irreversible, diverse, or unprecedented. These
impacts may affect an area larger than the sites or facilities subject to physical
works. An environmental impact assessment (EIA), including an environmental
management plan (EMP), is required.
 Category B. The proposed project’s potential adverse environmental impacts
are site-specific, few if any of them are irreversible, and in most cases mitigation
measures can be designed more readily than for category A projects. An initial
environmental examination (IEE), including an EMP, is required.
 Category C. A proposed project is likely to have minimal or no adverse
environmental impacts. An EIA or IEE is not required, although environmental
implications need to be reviewed.

GUIDELINE DOCUMENTS- AVAILABLE
WB ADB
ESMF (Environmental Social
Management Framework)
SMF Social Management
Framework (CPF)
VF (Venerable Framework)
EMF (Environment
Management
Framework)
ECoP (Environment Codes of
EARF (Environmental
Assessment Review
Framework)
SPS 2012 (Safeguard Policy
Statement)
CPF/CPP (Community
Participation Framework/Plan)
ECoP (Environment Codes of
Practice)

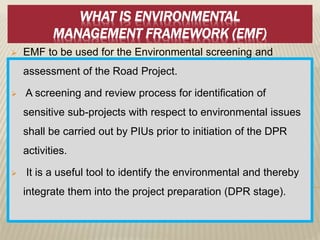

WHAT IS ENVIRONMENTAL
MANAGEMENT FRAMEWORK (EMF)
 EMF to be used for the Environmental screening and
assessment of the Road Project.
 A screening and review process for identification of
sensitive sub-projects with respect to environmental issues
shall be carried out by PIUs prior to initiation of the DPR
activities.
 It is a useful tool to identify the environmental and thereby
integrate them into the project preparation (DPR stage).

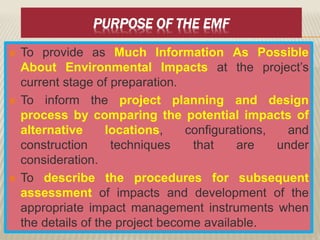

PURPOSE OF THE EMF
 To provide as Much Information As Possible
About Environmental Impacts at the project’s
current stage of preparation.
 To inform the project planning and design
process by comparing the potential impacts of
alternative locations, configurations, and
construction techniques that are under
consideration.
 To describe the procedures for subsequent
assessment of impacts and development of the
appropriate impact management instruments when
the details of the project become available.
Tools of Transect Walk for
Environment Feature recorded
ENVIRONMENTAL ASPECTS
Climatic condition
No. of Trees /Forest if any
Wild Life if any
Pond/River/Water crossings
Irrigation water duct
Grazing grounds
No of Utilities Shifting/ ELCs
Schools/Hospitals/Structures
Borrow area identification
Community consultation and
suggestions
No. of Field drain required
Seasonal markets and cultural

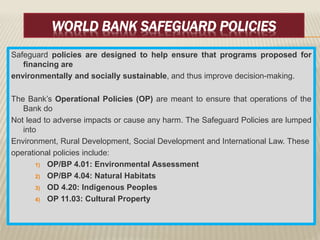

WORLD BANK SAFEGUARD POLICIES
Safeguard policies are designed to help ensure that programs proposed for
financing are
environmentally and socially sustainable, and thus improve decision-making.
The Bank’s Operational Policies (OP) are meant to ensure that operations of the
Bank do
Not lead to adverse impacts or cause any harm. The Safeguard Policies are lumped
into
Environment, Rural Development, Social Development and International Law. These
operational policies include:
1) OP/BP 4.01: Environmental Assessment
2) OP/BP 4.04: Natural Habitats
3) OD 4.20: Indigenous Peoples
4) OP 11.03: Cultural Property

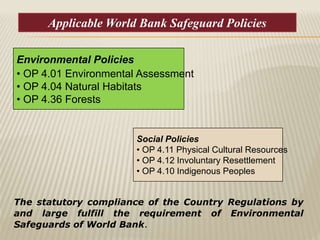

Social Policies
• OP 4.11 Physical Cultural Resources
• OP 4.12 Involuntary Resettlement
• OP 4.10 Indigenous Peoples
Environmental Policies
• OP 4.01 Environmental Assessment
• OP 4.04 Natural Habitats
• OP 4.36 Forests
The statutory compliance of the Country Regulations by
and large fulfill the requirement of Environmental
Safeguards of World Bank.
Applicable World Bank Safeguard Policies

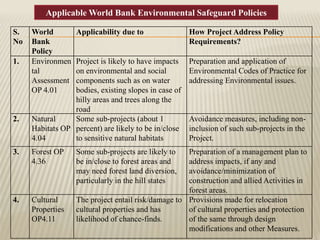

Applicable World Bank Environmental Safeguard Policies
S.
No
World
Bank
Policy
Applicability due to How Project Address Policy
Requirements?
1. Environmen
tal
Assessment
OP 4.01
Project is likely to have impacts
on environmental and social
components such as on water
bodies, existing slopes in case of
hilly areas and trees along the
road
Preparation and application of
Environmental Codes of Practice for
addressing Environmental issues.
2. Natural
Habitats OP
4.04
Some sub-projects (about 1
percent) are likely to be in/close
to sensitive natural habitats
Avoidance measures, including non-
inclusion of such sub-projects in the
Project.
3. Forest OP
4.36
Some sub-projects are likely to
be in/close to forest areas and
may need forest land diversion,
particularly in the hill states
Preparation of a management plan to
address impacts, if any and
avoidance/minimization of
construction and allied Activities in
forest areas.
4. Cultural
Properties
OP4.11
The project entail risk/damage to
cultural properties and has
likelihood of chance-finds.
Provisions made for relocation
of cultural properties and protection
of the same through design
modifications and other Measures.

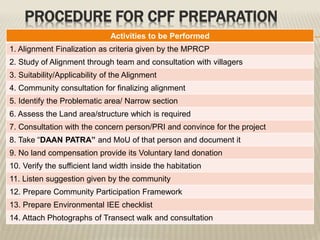

ROLE OF PIU FOR SAFEGUARD
 To assure DPR should have IEE checklist
 To assure the IEE findings are reflects in
the DPR technical part as environmental
management cost.
 Put effort to avoid tree cutting and focus
on tree plantation.

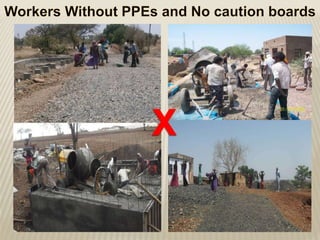

 Ensure the Labours are using PPEs while
they work at site like Helmet, jackets,
boots Gloves etc.

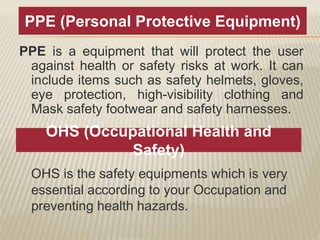

PPE is a equipment that will protect the user
against health or safety risks at work. It can
include items such as safety helmets, gloves,
eye protection, high-visibility clothing and
Mask safety footwear and safety harnesses.
PPE (Personal Protective Equipment)
OHS (Occupational Health and
Safety)
OHS is the safety equipments which is very
essential according to your Occupation and
preventing health hazards.

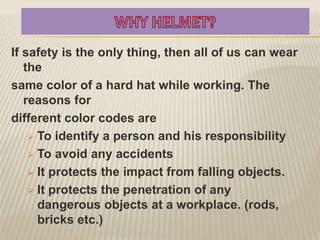

If safety is the only thing, then all of us can wear
the
same color of a hard hat while working. The
reasons for
different color codes are
 To identify a person and his responsibility
 To avoid any accidents
 It protects the impact from falling objects.
 It protects the penetration of any
dangerous objects at a workplace. (rods,
bricks etc.)
COLOR IMAGE FOR
WHITE Managers, Engineers, Supervisors and
Foremen
BLUE Electricians, Carpenters and other technical
operators apart from civil workers
GREEN Safety Officers
RED Fire Fighters
YELLOW Laborers
BROWN Welders and workers with high heat
application
GREY Site Visitors
HELMET COLOR CODE

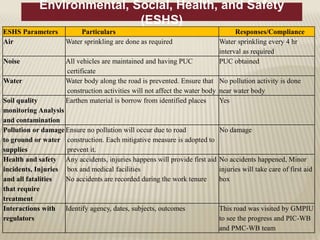

Environmental, Social, Health, and Safety
(ESHS)

ESHS Parameters Particulars Responses/Compliance

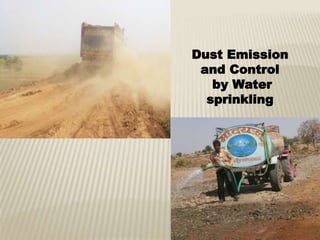

Air Water sprinkling are done as required Water sprinkling every 4 hr
interval as required
Noise All vehicles are maintained and having PUC
certificate
PUC obtained
Water Water body along the road is prevented. Ensure that
construction activities will not affect the water body
No pollution activity is done
near water body
Soil quality
monitoring Analysis
and contamination
Earthen material is borrow from identified places Yes
Pollution or damage
to ground or water
supplies
Ensure no pollution will occur due to road
construction. Each mitigative measure is adopted to
prevent it.
No damage
Health and safety
incidents, Injuries
and all fatalities
that require
treatment
Any accidents, injuries happens will provide first aid
box and medical facilities
No accidents are recorded during the work tenure
No accidents happened, Minor
injuries will take care of first aid
box
Interactions with
regulators
Identify agency, dates, subjects, outcomes This road was visited by GMPIU
to see the progress and PIC-WB
and PMC-WB team

ESHS Parameters Particulars Responses/Compliance
Status of all permits
and agreements
List areas/facilities with permits required
•Licenses Quarries
•Asphalt & batch plants operation and establishment
•Dates of application of utility shifting
•Dates submitted to resident engineer (or equivalent), status
of area (waiting for permits, working, abandoned without
reclamation, Decommissioning plan being implemented
•List areas with landowner agreements required
•Borrow and spoil areas: Soil taken from the identified area
•Camp sites: Provide at identified places
•Dates of agreements, and dates submitted to resident
engineer (or equivalent)
Quarries Licenses attached
Asphalt & batch plants operation
and establishment attached
Utility shifting application
attached
Health and safety
supervision
Safety officer name
•Number of days worked
•Number of full inspections & partial inspections
•Reports to construction/project management
•Number of workers
•Work hours
•Metric of PPE use (percentage of workers with full
personal protection equipment (PPE), partial, etc.)
•Worker violations observed (by type of violation, PPE or
otherwise)
•Warnings and Repeat warnings given
•Follow-up actions taken (if any)
Safety officer name-XXX
Number of days worked-XX
Number of full inspections &
partial inspections
Reports to construction/project
management
Number of workers –XXX
Work hours-9
ESHS
Parameters
Particulars Responses/Compliance
Worker

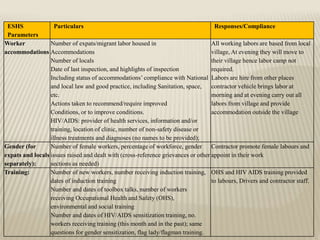

accommodations

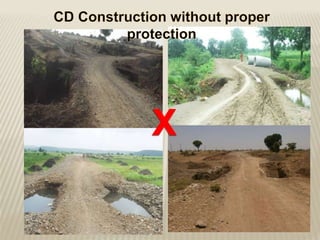

Number of expats/migrant labor housed in
Accommodations
Number of locals
Date of last inspection, and highlights of inspection
Including status of accommodations’ compliance with National
and local law and good practice, including Sanitation, space,
etc.
Actions taken to recommend/require improved
Conditions, or to improve conditions.
HIV/AIDS: provider of health services, information and/or
training, location of clinic, number of non-safety disease or
illness treatments and diagnoses (no names to be provided);
All working labors are based from local
village, At evening they will move to
their village hence labor camp not
required.
Labors are hire from other places
contractor vehicle brings labor at
morning and at evening carry out all
labors from village and provide
accommodation outside the village
Gender (for
expats and locals
separately):
Number of female workers, percentage of workforce, gender
issues raised and dealt with (cross-reference grievances or other
sections as needed)
Contractor promote female labours and
appoint in their work
Training: Number of new workers, number receiving induction training,
dates of induction training
Number and dates of toolbox talks, number of workers
receiving Occupational Health and Safety (OHS),
environmental and social training
Number and dates of HIV/AIDS sensitization training, no.
workers receiving training (this month and in the past); same
questions for gender sensitization, flag lady/flagman training.
OHS and HIV AIDS training provided
to labours, Drivers and contractor staff.
ESHS
Parameters
Particulars Responses/Compliance
Environmental
and social
supervision:
Environmentalist: days worked, areas inspected and numbers
of inspections of each (road section, work camp,
accommodations, quarries, borrow areas, spoil areas, swamps,
forest crossings, etc.), highlights of activities/findings
(including violations of environmental and/or social best
practices, actions taken), reports to environmental and/or social
specialist/construction/site management
Contractor Environmental
expert (more than 5 corore
pkg.) check and report
Community
liaison
person(s)-cum-
Sociologist:
Sociologist Days worked (hours community center open),
number of people met, highlights of activities (issues raised,
etc.), reports to environmental specialist /construction/site
management.; number of partial and full site inspections (by
area: road section, work camp, accommodations, quarries,
borrow areas, spoil areas, clinic, HIV/AIDS center, community
centers, etc.), highlights of activities (including violations of
environmental and/or social requirements observed, actions
taken)
Contractor Social expert
(more than 5 corore pkg.)
check and report
Grievances:
List this month’s and unresolved past grievances by date
received, complainant, how received, to whom referred
to for action, resolution and date (if completed), data
resolution reported to complainant, any required follow-
up (Cross-reference other sections as needed):
Worker grievances
Community grievances
No grievances received
from community.
Community have
grievances near the
habitation drain, contractor
will construct the drain.
ESHS
Parameters
Particulars Responses/Compliance
Traffic and
vehicles/equip
ment:
Provide date, location, damage, cause, follow Accidents. Overall condition of
vehicles/equipment (subjective judgment by environmentalist); non
During construction
contractor demarcated area
with signs and provide
diversion as required for
traffic movement
Environmental
mitigations and
issues (what
has been done):
Dust: Number of watering/day, number of complaints, warnings given by
environmentalist, actions taken to resolve, highlights of quarry dust control
(covers, sprays, operational status), % of rock/muram/spoil lorries with covers,
actions taken for uncovered vehicles.
Erosion control: Controls implemented by location, status of water crossings,
environmentalist inspections and results, actions taken to resolve issues,
Quarries, borrow areas, asphalt plants,
Social protection: Land clearing, boundary marking, topsoil salvage, traffic
management, decommissioning planning, decommissioning implementation
Blasting: Number of blasts (and locations), status of implementation of blasting
plan (including notices, evacuations, etc.), incidents of off-site damage or
complaints (cross-reference other sections as needed)
Spill cleanups, if any: Material spilled, location, amount, actions taken,
material disposal (report all spills that result in water or soil contamination
Waste management: Types and quantities generated and managed, including
amount taken offsite (and by whom) or reused/recycled/disposed on-site
Details of tree plantings and other mitigations required undertaken this month
Details of water and swamp protection mitigations required undertaken this
month.
Water sprinkling during
working hours as required.
To control erosion Turfing
and plantation activity
promoted.
License quarry are using for
borrow material
No blasting activity required
Waste will be collected from
the working site and dispose
in proper manner.
ESHS Parameters Particulars Responses/Compliance
Compliance: Compliance status for conditions of all relevant consents/permits, for the
Work, including quarries, etc.): statement of compliance or listing of issues
and actions taken (or to be taken) to reach compliance
Compliance status of ESMP/ESIP requirements: statement of compliance or
listing of issues and actions taken (or to be taken) to reach compliance
Other unresolved issues from previous months related to environmental and
social: continued violations, continued failure of equipment, continued lack
of vehicle covers, spills not dealt with, continued compensation or blasting
issues, etc. Cross-reference other sections as needed.
Compliance report will
be submit as required
(Signature of Contractor)
Project
Stage
Activity requiring
clearance
Agency from whom
clearance to be sought
Legislative requirement Responsibility
PRECONSTRUCTION
Diversion of
Alignment through
Sensitive Areas
Forest Department.
Wildlife Department
Forest (Conservation) Rule 1980, The Wildlife
Protection Act, 1972, etc Environmental (Protection)
Act, 1986
PIU
Water for
Construction
Ground Water Board WB,
Irrigation department/
Village councils
Control on setting up of Tube Wells in notified areas Contractor
Stone Quarry
Mining Department and
District Level
Environmental Impact
Assessment Authority
Madhya Pradesh Minor Mineral Rules, 1996
EIA Notification 2006 and subsequent amendments
under The Environmental (Protection) Act, 1986
Contractor
Earth Borrow Area
and Sand Mining
Mining Department and
District Level
Environmental Impact
Assessment Authority
EIA Notification 2006 and subsequent amendments
under The Environmental (Protection) Act, 1986
Contractor
Compliance to Legal Requirements
The clearance requirements as per the various legislations in force towards the conservation of the
environment during the various project stages, as applicable to the project are presented in
DURINGCONSTRUCTION

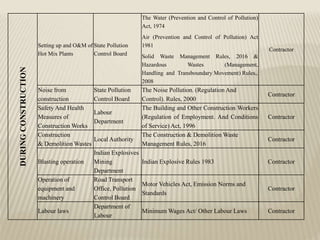

Setting up and O&M of
Hot Mix Plants
State Pollution
Control Board
The Water (Prevention and Control of Pollution)
Act, 1974
Air (Prevention and Control of Pollution) Act
1981
Solid Waste Management Rules, 2016 &
Hazardous Wastes (Management,
Handling and Transboundary Movement) Rules,.
2008
Contractor
Noise from
construction
State Pollution
Control Board
The Noise Pollution. (Regulation And
Control). Rules, 2000
Contractor
Safety And Health
Measures of
Construction Works
Labour
Department
The Building and Other Construction Workers
(Regulation of Employment. And Conditions
of Service) Act, 1996
Contractor
Construction
& Demolition Wastes
Local Authority
The Construction & Demolition Waste
Management Rules, 2016
Contractor
Blasting operation
Indian Explosives
Mining
Department
Indian Explosive Rules 1983 Contractor
Operation of
equipment and
machinery
Road Transport
Office, Pollution
Control Board
Motor Vehicles Act, Emission Norms and
Standards
Contractor
Labour laws
Department of
Labour
Minimum Wages Act/ Other Labour Laws Contractor
ROLE OF SAFEGUARD CELL
•Coordination of planning and implementation of environmental and social
management aspects.
•Obtain clearances through concerned PIUs from the line departments,
especially MoEF&CC, Forest Department, SPCB (as applicable).
•Monitor MPRCP rural roads for fulfillment of ESMF provisions in co-
ordination with the PMC, Panel of Retired Senior Engineers of Road Sector
and PIUs.
•Organize training program with the help of PMC for PIUs, Panel of Retired
Senior Engineers of Road Sector and Contractors for capacity building for
implementation of EMF and ECoPs
•Mobilize community and ensure their participation in addressing
ESMF/ECoPs provisions.
•Inspection, monitoring and report progress, highlighting environmental and
social issues not addressed, to provide for further course of correction.

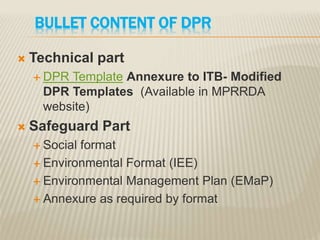

BULLET CONTENT OF DPR
 Technical part
 DPR Template Annexure to ITB- Modified
DPR Templates (Available in MPRRDA
website)
 Safeguard Part
 Social format
 Environmental Format (IEE)
 Environmental Management Plan (EMaP)
 Annexure as required by format
Activities to be Performed
1. Alignment Finalization as criteria given by the MPRCP
2. Study of Alignment through team and consultation with villagers
3. Suitability/Applicability of the Alignment
4. Community consultation for finalizing alignment
5. Identify the Problematic area/ Narrow section
6. Assess the Land area/structure which is required
7. Consultation with the concern person/PRI and convince for the project
8. Take “DAAN PATRA” and MoU of that person and document it
9. No land compensation provide its Voluntary land donation
10. Verify the sufficient land width inside the habitation
11. Listen suggestion given by the community
12. Prepare Community Participation Framework
13. Prepare Environmental IEE checklist
14. Attach Photographs of Transect walk and consultation
PROCEDURE FOR CPF PREPARATION

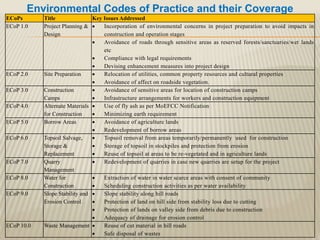

ECoPs Title Key Issues Addressed
ECoP 1.0 Project Planning &
Design
 Incorporation of environmental concerns in project preparation to avoid impacts in
construction and operation stages
 Avoidance of roads through sensitive areas as reserved forests/sanctuaries/wet lands
etc
 Compliance with legal requirements
 Devising enhancement measures into project design
ECoP 2.0 Site Preparation  Relocation of utilities, common property resources and cultural properties
 Avoidance of affect on roadside vegetation.
ECoP 3.0 Construction
Camps
 Avoidance of sensitive areas for location of construction camps
 Infrastructure arrangements for workers and construction equipment
ECoP 4.0 Alternate Materials
for Construction
 Use of fly ash as per MoEFCC Notification
 Minimizing earth requirement
ECoP 5.0 Borrow Areas  Avoidance of agriculture lands
 Redevelopment of borrow areas
ECoP 6.0 Topsoil Salvage,
Storage &
Replacement
 Topsoil removal from areas temporarily/permanently used for construction
 Storage of topsoil in stockpiles and protection from erosion
 Reuse of topsoil at areas to be re-vegetated and in agriculture lands
ECoP 7.0 Quarry
Management
 Redevelopment of quarries in case new quarries are setup for the project
ECoP 8.0 Water for
Construction
 Extraction of water in water scarce areas with consent of community
 Scheduling construction activities as per water availability
ECoP 9.0 Slope Stability and
Erosion Control
 Slope stability along hill roads
 Protection of land on hill side from stability loss due to cutting
 Protection of lands on valley side from debris due to construction
 Adequacy of drainage for erosion control
ECoP 10.0 Waste Management  Reuse of cut material in hill roads
 Safe disposal of wastes
Environmental Codes of Practice and their Coverage
ECoPs Title Key Issues Addressed
ECoP 11.0 Water Bodies  Avoidance from cutting due to alignment
 Protection of embankment slopes in case of alignment on embankments
 Rehabilitation of water body
ECoP 12.0 Drainage  Conduct of hydrological investigations during project preparation
 Provision of longitudinal and cross drainage as per requirements
 Proper location of drainage outfall
ECoP 13.0 Construction
Plants &
Equipment
Management
 Compliance of construction plants and equipment with emission standards of Central
Pollution Control Board
 Maintenance of machinery and equipment to avoid pollution
ECoP 14.0 Public and
Worker's Health
& Safety
 Provision of Personal Protective Equipment to workers
 Provision of basic necessities to workers
 Public safety while travel along construction sites
 Public safety during operation of the road
ECoP 15.0 Cultural
Properties
 Avoidance of impacts due to project
 Protection of precincts from impacts due to construction
 Relocation in case impacts are unavoidable
ECoP 16.0 Tree Plantation  Avoidance of impact on trees
 Plantation of trees on roadside
ECoP 17.0 Managing
Induced
Development
 Restricting ribbon development at junctions and bus stops
 Earmarking areas for commercial activities and other amenities
ECoP 18.0 Environmental
Audit
 Monitoring of environmental and social parameters during project planning,
construction and implementation
ECoP 20.0 Consultation
Framework
 Aspects for consultation
 Stage wise consultations
 Consultation schedule and responsibilities
COMPREHENSIVE ENVIRONMENT
MANAGEMENT PLAN (EMaP)
 Environment Management Plan (EMaP) is a
document which shows the mitigation measures
of the particular environmental loss of the
project area. It follows the rules of ECoPs and
other state prevailing environmental laws. The
EMaPs covers the short term and long term
effects of the project and how it will affect our
environment as well as how we can manage
with taken effective measures.
COMMON DPR SAFEGUARD COMMENTS
 For safeguard (Social and Environment) the experts are not giving their efficient
input.
 Social safeguard and Environment safeguard file not attached and if attached
they are not filled in proper manner.
 Many format attachments are missing.
 Tree list, utilities and community structure list not properly recorded.
 Tree cutting list information not given and what will be the plantation scheme
proposed.
 CPF file have not signed by the PIU and Sarpanch wherever is required.
 CPF not given questionnaire according answer/response but its filled very
casually like below
 Question: Are community giving any suggestion?
 Answer: Yes, the suggestion given by the community is incorporated
(but
not mentions the type of suggestion they gave).
 Transect walk findings not gave detail information as required.
 Community consultation photographs not attached.
 Consultant used villagers services for their own work like holding chainage slate
 Their environmental and social experts not had gone through
the safeguard report not even field.
 No APs and VAPs found in earthen road is also a big
question of transect walk survey.
 Women participation ratio is very less or negligible in DPR
transect walk.
 Many data are not matched with the actual site condition as
attached photographs.
 Sequences of the pages are missing. Papers are attached in
any where find space.
 Photo plate’s captions are the same repetitive manner
instead of particular.
 Very low participation of the community. CPF Report is made
technically sound instead of socially sound.
Dust Emission
and Control
by Water
sprinkling
Involving Women For work
First Aid Box Should Available at work site
WORK FOR OUR
NEXT GENERATION
WORK FOR HEALTHY
ENVIRONMENT

Provision in the project formulation for Environment for Road projects

  • 1.
    Dr Deepak KumarTripathi Environmental Expert
  • 2.
  • 3.
    SAFEGUARD DEFINITION  Ameasure taken to protect someone or something or to prevent something which is undesirable.  Something that provides protection against possible loss, damage, etc.  Protect from harm or damage with an 3
  • 4.
    SAFEGUARD REQUIREMENT  EnvironmentalSafeguards  Social Safeguards  Road safety Safeguards
  • 5.
    SAFEGUARD POLICY STATEMENT(SPS) The Safeguard Policy Statement (SPS), approved in July 2009 and became effective in January 2010, to enhance relevance and effectiveness Why Safeguard Policy ADB’s Approach ADB commits to avoid, minimize, mitigate, and compensate for the adverse impacts through well-designed and appropriately-implemented plans/programs on environmental management, resettlement and indigenous peoples Overarching Objectives of the SPS Avoid adverse impacts of projects on the environment and affected people, where possible; Minimize, mitigate, and/or compensate for adverse project impacts on the environment and affected people when avoidance is not possible; and Help borrowers/clients to strengthen their safeguard systems and develop the capacity to manage environmental and social risks.
  • 6.
     Need toensure that all Bank financed projects and programs are environmentally and socially sustainable as well as in line with Bank’s policies and guidelines, involving stakeholder participation and timely public disclosure.  Ensure that all possible negative impacts are considered and mitigation measures are spelled out prior to implementation of any proposed project Why Environmental Safeguards required for Projects?
  • 7.
    SOCIAL Public participation (Male, Female,Senior citizen, students) Environment Physical, Social, Biological Safety and mobility Workers and Public Engineering Design Socially acceptable Environmentally sound and Economically sustainable Safeguard
  • 8.
    ENVIRONMENTAL PROJECT CATEGORY Proposedprojects are screened according to type, location, scale, and sensitivity and the magnitude of their potential environmental impacts, including direct, indirect, induced, and cumulative impacts. Projects are classified into the following four categories:  Category A. A proposed project is likely to have significant adverse environmental impacts that are irreversible, diverse, or unprecedented. These impacts may affect an area larger than the sites or facilities subject to physical works. An environmental impact assessment (EIA), including an environmental management plan (EMP), is required.  Category B. The proposed project’s potential adverse environmental impacts are site-specific, few if any of them are irreversible, and in most cases mitigation measures can be designed more readily than for category A projects. An initial environmental examination (IEE), including an EMP, is required.  Category C. A proposed project is likely to have minimal or no adverse environmental impacts. An EIA or IEE is not required, although environmental implications need to be reviewed.
  • 9.
    GUIDELINE DOCUMENTS- AVAILABLE WBADB ESMF (Environmental Social Management Framework) SMF Social Management Framework (CPF) VF (Venerable Framework) EMF (Environment Management Framework) ECoP (Environment Codes of EARF (Environmental Assessment Review Framework) SPS 2012 (Safeguard Policy Statement) CPF/CPP (Community Participation Framework/Plan) ECoP (Environment Codes of Practice)
  • 10.
    WHAT IS ENVIRONMENTAL MANAGEMENTFRAMEWORK (EMF)  EMF to be used for the Environmental screening and assessment of the Road Project.  A screening and review process for identification of sensitive sub-projects with respect to environmental issues shall be carried out by PIUs prior to initiation of the DPR activities.  It is a useful tool to identify the environmental and thereby integrate them into the project preparation (DPR stage).
  • 11.
    PURPOSE OF THEEMF  To provide as Much Information As Possible About Environmental Impacts at the project’s current stage of preparation.  To inform the project planning and design process by comparing the potential impacts of alternative locations, configurations, and construction techniques that are under consideration.  To describe the procedures for subsequent assessment of impacts and development of the appropriate impact management instruments when the details of the project become available.
  • 12.
    Tools of TransectWalk for Environment Feature recorded ENVIRONMENTAL ASPECTS Climatic condition No. of Trees /Forest if any Wild Life if any Pond/River/Water crossings Irrigation water duct Grazing grounds No of Utilities Shifting/ ELCs Schools/Hospitals/Structures Borrow area identification Community consultation and suggestions No. of Field drain required Seasonal markets and cultural
  • 13.
    WORLD BANK SAFEGUARDPOLICIES Safeguard policies are designed to help ensure that programs proposed for financing are environmentally and socially sustainable, and thus improve decision-making. The Bank’s Operational Policies (OP) are meant to ensure that operations of the Bank do Not lead to adverse impacts or cause any harm. The Safeguard Policies are lumped into Environment, Rural Development, Social Development and International Law. These operational policies include: 1) OP/BP 4.01: Environmental Assessment 2) OP/BP 4.04: Natural Habitats 3) OD 4.20: Indigenous Peoples 4) OP 11.03: Cultural Property
  • 14.
    Social Policies • OP4.11 Physical Cultural Resources • OP 4.12 Involuntary Resettlement • OP 4.10 Indigenous Peoples Environmental Policies • OP 4.01 Environmental Assessment • OP 4.04 Natural Habitats • OP 4.36 Forests The statutory compliance of the Country Regulations by and large fulfill the requirement of Environmental Safeguards of World Bank. Applicable World Bank Safeguard Policies
  • 15.
    Applicable World BankEnvironmental Safeguard Policies S. No World Bank Policy Applicability due to How Project Address Policy Requirements? 1. Environmen tal Assessment OP 4.01 Project is likely to have impacts on environmental and social components such as on water bodies, existing slopes in case of hilly areas and trees along the road Preparation and application of Environmental Codes of Practice for addressing Environmental issues. 2. Natural Habitats OP 4.04 Some sub-projects (about 1 percent) are likely to be in/close to sensitive natural habitats Avoidance measures, including non- inclusion of such sub-projects in the Project. 3. Forest OP 4.36 Some sub-projects are likely to be in/close to forest areas and may need forest land diversion, particularly in the hill states Preparation of a management plan to address impacts, if any and avoidance/minimization of construction and allied Activities in forest areas. 4. Cultural Properties OP4.11 The project entail risk/damage to cultural properties and has likelihood of chance-finds. Provisions made for relocation of cultural properties and protection of the same through design modifications and other Measures.
  • 16.
    ROLE OF PIUFOR SAFEGUARD  To assure DPR should have IEE checklist  To assure the IEE findings are reflects in the DPR technical part as environmental management cost.  Put effort to avoid tree cutting and focus on tree plantation.  Ensure the Labours are using PPEs while they work at site like Helmet, jackets, boots Gloves etc.
  • 17.
    PPE is aequipment that will protect the user against health or safety risks at work. It can include items such as safety helmets, gloves, eye protection, high-visibility clothing and Mask safety footwear and safety harnesses. PPE (Personal Protective Equipment) OHS (Occupational Health and Safety) OHS is the safety equipments which is very essential according to your Occupation and preventing health hazards.
  • 18.
    If safety isthe only thing, then all of us can wear the same color of a hard hat while working. The reasons for different color codes are  To identify a person and his responsibility  To avoid any accidents  It protects the impact from falling objects.  It protects the penetration of any dangerous objects at a workplace. (rods, bricks etc.)
  • 19.
    COLOR IMAGE FOR WHITEManagers, Engineers, Supervisors and Foremen BLUE Electricians, Carpenters and other technical operators apart from civil workers GREEN Safety Officers RED Fire Fighters YELLOW Laborers BROWN Welders and workers with high heat application GREY Site Visitors HELMET COLOR CODE
  • 20.
    Environmental, Social, Health,and Safety (ESHS) ESHS Parameters Particulars Responses/Compliance Air Water sprinkling are done as required Water sprinkling every 4 hr interval as required Noise All vehicles are maintained and having PUC certificate PUC obtained Water Water body along the road is prevented. Ensure that construction activities will not affect the water body No pollution activity is done near water body Soil quality monitoring Analysis and contamination Earthen material is borrow from identified places Yes Pollution or damage to ground or water supplies Ensure no pollution will occur due to road construction. Each mitigative measure is adopted to prevent it. No damage Health and safety incidents, Injuries and all fatalities that require treatment Any accidents, injuries happens will provide first aid box and medical facilities No accidents are recorded during the work tenure No accidents happened, Minor injuries will take care of first aid box Interactions with regulators Identify agency, dates, subjects, outcomes This road was visited by GMPIU to see the progress and PIC-WB and PMC-WB team
  • 21.
    ESHS Parameters ParticularsResponses/Compliance Status of all permits and agreements List areas/facilities with permits required •Licenses Quarries •Asphalt & batch plants operation and establishment •Dates of application of utility shifting •Dates submitted to resident engineer (or equivalent), status of area (waiting for permits, working, abandoned without reclamation, Decommissioning plan being implemented •List areas with landowner agreements required •Borrow and spoil areas: Soil taken from the identified area •Camp sites: Provide at identified places •Dates of agreements, and dates submitted to resident engineer (or equivalent) Quarries Licenses attached Asphalt & batch plants operation and establishment attached Utility shifting application attached Health and safety supervision Safety officer name •Number of days worked •Number of full inspections & partial inspections •Reports to construction/project management •Number of workers •Work hours •Metric of PPE use (percentage of workers with full personal protection equipment (PPE), partial, etc.) •Worker violations observed (by type of violation, PPE or otherwise) •Warnings and Repeat warnings given •Follow-up actions taken (if any) Safety officer name-XXX Number of days worked-XX Number of full inspections & partial inspections Reports to construction/project management Number of workers –XXX Work hours-9
  • 22.
    ESHS Parameters Particulars Responses/Compliance Worker accommodations Number ofexpats/migrant labor housed in Accommodations Number of locals Date of last inspection, and highlights of inspection Including status of accommodations’ compliance with National and local law and good practice, including Sanitation, space, etc. Actions taken to recommend/require improved Conditions, or to improve conditions. HIV/AIDS: provider of health services, information and/or training, location of clinic, number of non-safety disease or illness treatments and diagnoses (no names to be provided); All working labors are based from local village, At evening they will move to their village hence labor camp not required. Labors are hire from other places contractor vehicle brings labor at morning and at evening carry out all labors from village and provide accommodation outside the village Gender (for expats and locals separately): Number of female workers, percentage of workforce, gender issues raised and dealt with (cross-reference grievances or other sections as needed) Contractor promote female labours and appoint in their work Training: Number of new workers, number receiving induction training, dates of induction training Number and dates of toolbox talks, number of workers receiving Occupational Health and Safety (OHS), environmental and social training Number and dates of HIV/AIDS sensitization training, no. workers receiving training (this month and in the past); same questions for gender sensitization, flag lady/flagman training. OHS and HIV AIDS training provided to labours, Drivers and contractor staff.
  • 23.
    ESHS Parameters Particulars Responses/Compliance Environmental and social supervision: Environmentalist:days worked, areas inspected and numbers of inspections of each (road section, work camp, accommodations, quarries, borrow areas, spoil areas, swamps, forest crossings, etc.), highlights of activities/findings (including violations of environmental and/or social best practices, actions taken), reports to environmental and/or social specialist/construction/site management Contractor Environmental expert (more than 5 corore pkg.) check and report Community liaison person(s)-cum- Sociologist: Sociologist Days worked (hours community center open), number of people met, highlights of activities (issues raised, etc.), reports to environmental specialist /construction/site management.; number of partial and full site inspections (by area: road section, work camp, accommodations, quarries, borrow areas, spoil areas, clinic, HIV/AIDS center, community centers, etc.), highlights of activities (including violations of environmental and/or social requirements observed, actions taken) Contractor Social expert (more than 5 corore pkg.) check and report Grievances: List this month’s and unresolved past grievances by date received, complainant, how received, to whom referred to for action, resolution and date (if completed), data resolution reported to complainant, any required follow- up (Cross-reference other sections as needed): Worker grievances Community grievances No grievances received from community. Community have grievances near the habitation drain, contractor will construct the drain.
  • 24.
    ESHS Parameters Particulars Responses/Compliance Traffic and vehicles/equip ment: Providedate, location, damage, cause, follow Accidents. Overall condition of vehicles/equipment (subjective judgment by environmentalist); non During construction contractor demarcated area with signs and provide diversion as required for traffic movement Environmental mitigations and issues (what has been done): Dust: Number of watering/day, number of complaints, warnings given by environmentalist, actions taken to resolve, highlights of quarry dust control (covers, sprays, operational status), % of rock/muram/spoil lorries with covers, actions taken for uncovered vehicles. Erosion control: Controls implemented by location, status of water crossings, environmentalist inspections and results, actions taken to resolve issues, Quarries, borrow areas, asphalt plants, Social protection: Land clearing, boundary marking, topsoil salvage, traffic management, decommissioning planning, decommissioning implementation Blasting: Number of blasts (and locations), status of implementation of blasting plan (including notices, evacuations, etc.), incidents of off-site damage or complaints (cross-reference other sections as needed) Spill cleanups, if any: Material spilled, location, amount, actions taken, material disposal (report all spills that result in water or soil contamination Waste management: Types and quantities generated and managed, including amount taken offsite (and by whom) or reused/recycled/disposed on-site Details of tree plantings and other mitigations required undertaken this month Details of water and swamp protection mitigations required undertaken this month. Water sprinkling during working hours as required. To control erosion Turfing and plantation activity promoted. License quarry are using for borrow material No blasting activity required Waste will be collected from the working site and dispose in proper manner.
  • 25.
    ESHS Parameters ParticularsResponses/Compliance Compliance: Compliance status for conditions of all relevant consents/permits, for the Work, including quarries, etc.): statement of compliance or listing of issues and actions taken (or to be taken) to reach compliance Compliance status of ESMP/ESIP requirements: statement of compliance or listing of issues and actions taken (or to be taken) to reach compliance Other unresolved issues from previous months related to environmental and social: continued violations, continued failure of equipment, continued lack of vehicle covers, spills not dealt with, continued compensation or blasting issues, etc. Cross-reference other sections as needed. Compliance report will be submit as required (Signature of Contractor)
  • 26.
    Project Stage Activity requiring clearance Agency fromwhom clearance to be sought Legislative requirement Responsibility PRECONSTRUCTION Diversion of Alignment through Sensitive Areas Forest Department. Wildlife Department Forest (Conservation) Rule 1980, The Wildlife Protection Act, 1972, etc Environmental (Protection) Act, 1986 PIU Water for Construction Ground Water Board WB, Irrigation department/ Village councils Control on setting up of Tube Wells in notified areas Contractor Stone Quarry Mining Department and District Level Environmental Impact Assessment Authority Madhya Pradesh Minor Mineral Rules, 1996 EIA Notification 2006 and subsequent amendments under The Environmental (Protection) Act, 1986 Contractor Earth Borrow Area and Sand Mining Mining Department and District Level Environmental Impact Assessment Authority EIA Notification 2006 and subsequent amendments under The Environmental (Protection) Act, 1986 Contractor Compliance to Legal Requirements The clearance requirements as per the various legislations in force towards the conservation of the environment during the various project stages, as applicable to the project are presented in
  • 27.
    DURINGCONSTRUCTION Setting up andO&M of Hot Mix Plants State Pollution Control Board The Water (Prevention and Control of Pollution) Act, 1974 Air (Prevention and Control of Pollution) Act 1981 Solid Waste Management Rules, 2016 & Hazardous Wastes (Management, Handling and Transboundary Movement) Rules,. 2008 Contractor Noise from construction State Pollution Control Board The Noise Pollution. (Regulation And Control). Rules, 2000 Contractor Safety And Health Measures of Construction Works Labour Department The Building and Other Construction Workers (Regulation of Employment. And Conditions of Service) Act, 1996 Contractor Construction & Demolition Wastes Local Authority The Construction & Demolition Waste Management Rules, 2016 Contractor Blasting operation Indian Explosives Mining Department Indian Explosive Rules 1983 Contractor Operation of equipment and machinery Road Transport Office, Pollution Control Board Motor Vehicles Act, Emission Norms and Standards Contractor Labour laws Department of Labour Minimum Wages Act/ Other Labour Laws Contractor
  • 28.
    ROLE OF SAFEGUARDCELL •Coordination of planning and implementation of environmental and social management aspects. •Obtain clearances through concerned PIUs from the line departments, especially MoEF&CC, Forest Department, SPCB (as applicable). •Monitor MPRCP rural roads for fulfillment of ESMF provisions in co- ordination with the PMC, Panel of Retired Senior Engineers of Road Sector and PIUs. •Organize training program with the help of PMC for PIUs, Panel of Retired Senior Engineers of Road Sector and Contractors for capacity building for implementation of EMF and ECoPs •Mobilize community and ensure their participation in addressing ESMF/ECoPs provisions. •Inspection, monitoring and report progress, highlighting environmental and social issues not addressed, to provide for further course of correction.
  • 29.

    BULLET CONTENT OFDPR  Technical part  DPR Template Annexure to ITB- Modified DPR Templates (Available in MPRRDA website)  Safeguard Part  Social format  Environmental Format (IEE)  Environmental Management Plan (EMaP)  Annexure as required by format
  • 30.
    Activities to bePerformed 1. Alignment Finalization as criteria given by the MPRCP 2. Study of Alignment through team and consultation with villagers 3. Suitability/Applicability of the Alignment 4. Community consultation for finalizing alignment 5. Identify the Problematic area/ Narrow section 6. Assess the Land area/structure which is required 7. Consultation with the concern person/PRI and convince for the project 8. Take “DAAN PATRA” and MoU of that person and document it 9. No land compensation provide its Voluntary land donation 10. Verify the sufficient land width inside the habitation 11. Listen suggestion given by the community 12. Prepare Community Participation Framework 13. Prepare Environmental IEE checklist 14. Attach Photographs of Transect walk and consultation PROCEDURE FOR CPF PREPARATION
  • 36.
    ECoPs Title KeyIssues Addressed ECoP 1.0 Project Planning & Design  Incorporation of environmental concerns in project preparation to avoid impacts in construction and operation stages  Avoidance of roads through sensitive areas as reserved forests/sanctuaries/wet lands etc  Compliance with legal requirements  Devising enhancement measures into project design ECoP 2.0 Site Preparation  Relocation of utilities, common property resources and cultural properties  Avoidance of affect on roadside vegetation. ECoP 3.0 Construction Camps  Avoidance of sensitive areas for location of construction camps  Infrastructure arrangements for workers and construction equipment ECoP 4.0 Alternate Materials for Construction  Use of fly ash as per MoEFCC Notification  Minimizing earth requirement ECoP 5.0 Borrow Areas  Avoidance of agriculture lands  Redevelopment of borrow areas ECoP 6.0 Topsoil Salvage, Storage & Replacement  Topsoil removal from areas temporarily/permanently used for construction  Storage of topsoil in stockpiles and protection from erosion  Reuse of topsoil at areas to be re-vegetated and in agriculture lands ECoP 7.0 Quarry Management  Redevelopment of quarries in case new quarries are setup for the project ECoP 8.0 Water for Construction  Extraction of water in water scarce areas with consent of community  Scheduling construction activities as per water availability ECoP 9.0 Slope Stability and Erosion Control  Slope stability along hill roads  Protection of land on hill side from stability loss due to cutting  Protection of lands on valley side from debris due to construction  Adequacy of drainage for erosion control ECoP 10.0 Waste Management  Reuse of cut material in hill roads  Safe disposal of wastes Environmental Codes of Practice and their Coverage
  • 37.
    ECoPs Title KeyIssues Addressed ECoP 11.0 Water Bodies  Avoidance from cutting due to alignment  Protection of embankment slopes in case of alignment on embankments  Rehabilitation of water body ECoP 12.0 Drainage  Conduct of hydrological investigations during project preparation  Provision of longitudinal and cross drainage as per requirements  Proper location of drainage outfall ECoP 13.0 Construction Plants & Equipment Management  Compliance of construction plants and equipment with emission standards of Central Pollution Control Board  Maintenance of machinery and equipment to avoid pollution ECoP 14.0 Public and Worker's Health & Safety  Provision of Personal Protective Equipment to workers  Provision of basic necessities to workers  Public safety while travel along construction sites  Public safety during operation of the road ECoP 15.0 Cultural Properties  Avoidance of impacts due to project  Protection of precincts from impacts due to construction  Relocation in case impacts are unavoidable ECoP 16.0 Tree Plantation  Avoidance of impact on trees  Plantation of trees on roadside ECoP 17.0 Managing Induced Development  Restricting ribbon development at junctions and bus stops  Earmarking areas for commercial activities and other amenities ECoP 18.0 Environmental Audit  Monitoring of environmental and social parameters during project planning, construction and implementation ECoP 20.0 Consultation Framework  Aspects for consultation  Stage wise consultations  Consultation schedule and responsibilities
  • 38.
    COMPREHENSIVE ENVIRONMENT MANAGEMENT PLAN(EMaP)  Environment Management Plan (EMaP) is a document which shows the mitigation measures of the particular environmental loss of the project area. It follows the rules of ECoPs and other state prevailing environmental laws. The EMaPs covers the short term and long term effects of the project and how it will affect our environment as well as how we can manage with taken effective measures.
  • 39.
    COMMON DPR SAFEGUARDCOMMENTS  For safeguard (Social and Environment) the experts are not giving their efficient input.  Social safeguard and Environment safeguard file not attached and if attached they are not filled in proper manner.  Many format attachments are missing.  Tree list, utilities and community structure list not properly recorded.  Tree cutting list information not given and what will be the plantation scheme proposed.  CPF file have not signed by the PIU and Sarpanch wherever is required.  CPF not given questionnaire according answer/response but its filled very casually like below  Question: Are community giving any suggestion?  Answer: Yes, the suggestion given by the community is incorporated (but not mentions the type of suggestion they gave).  Transect walk findings not gave detail information as required.  Community consultation photographs not attached.  Consultant used villagers services for their own work like holding chainage slate
  • 40.

     Their environmentaland social experts not had gone through the safeguard report not even field.  No APs and VAPs found in earthen road is also a big question of transect walk survey.  Women participation ratio is very less or negligible in DPR transect walk.  Many data are not matched with the actual site condition as attached photographs.  Sequences of the pages are missing. Papers are attached in any where find space.  Photo plate’s captions are the same repetitive manner instead of particular.  Very low participation of the community. CPF Report is made technically sound instead of socially sound.
  • 41.
  • 45.
  • 46.
    First Aid BoxShould Available at work site
  • 47.
    WORK FOR OUR NEXTGENERATION WORK FOR HEALTHY ENVIRONMENT
