Assignment on

Production & Operations Management

                submitted by

             Harikrishnan S.
               Happy V.S.
               Honey V.S.
              Job Thomas
             Yasser Bukari

                 Group II
        Semester – 4 MBA (PT) 2012

                submitted to
            Dr. Manoj Edward

 SCHOOL OF MANAGEMENT STUDIES
Cochin University of Science and Technology
             Cochin, Kerala
                PIN 682022
May 2012

           2

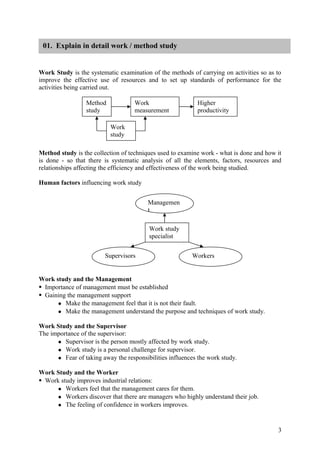

01. Explain in detail work / method study

Work Study is the systematic examination of the methods of carrying on activities so as to
improve the effective use of resources and to set up standards of performance for the
activities being carried out.

                 Method             Work                    Higher
                 study              measurement             productivity

                           Work
                           study

Method study is the collection of techniques used to examine work - what is done and how it
is done - so that there is systematic analysis of all the elements, factors, resources and
relationships affecting the efficiency and effectiveness of the work being studied.

Human factors influencing work study

                                         Managemen
                                         t

                                         Work study
                                         specialist

                         Supervisors                      Workers

Work study and the Management
Importance of management must be established
Gaining the management support
      Make the management feel that it is not their fault.
      Make the management understand the purpose and techniques of work study.

Work Study and the Supervisor
The importance of the supervisor:
      Supervisor is the person mostly affected by work study.
      Work study is a personal challenge for supervisor.
      Fear of taking away the responsibilities influences the work study.

Work Study and the Worker
Work study improves industrial relations:
      Workers feel that the management cares for them.
      Workers discover that there are managers who highly understand their job.
      The feeling of confidence in workers improves.

                                                                                         3
Workers are more able to carry out their jobs.

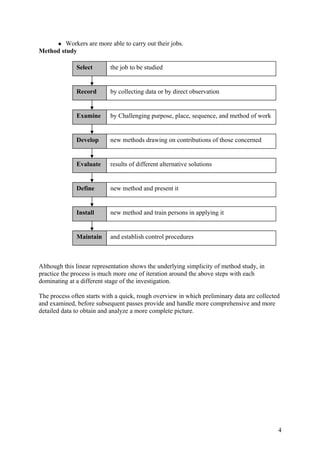

Method study

              Select       the job to be studied

              Record       by collecting data or by direct observation

              Examine      by Challenging purpose, place, sequence, and method of work

              Develop      new methods drawing on contributions of those concerned

              Evaluate     results of different alternative solutions

              Define       new method and present it

              Install      new method and train persons in applying it

              Maintain     and establish control procedures

Although this linear representation shows the underlying simplicity of method study, in
practice the process is much more one of iteration around the above steps with each
dominating at a different stage of the investigation.

The process often starts with a quick, rough overview in which preliminary data are collected
and examined, before subsequent passes provide and handle more comprehensive and more
detailed data to obtain and analyze a more complete picture.

                                                                                            4
02. Explain in detail time study

Time study is a tested method of work measurement for setting standard time for carrying out
a specified work. The aim of time study is to establish a time for a qualified worker to
perform specified work under stated conditions and at a defined rate of working.

Conditions in time study:

   •   the practitioner (observer) must be fully qualified to carry out Time Study,
   •   the person performing the task must be fully trained and experienced in the work,
   •   the work must be clearly defined and the method of doing the work must be effective
   •   the working conditions must be clearly defined

Essentials for establishing a basic time for specified work are rating and timing

Timing
The observer records the actual time taken to do the element or operation. This usually is in
centiminutes (0.01 min.) and is recorded, using a stop-watch or computerized study board.

Rating
 When someone is doing work his/her way of working will vary throughout the working
period and will be different from others doing the same work. This is due to differing speeds
of movement, effort, dexterity and consistency. Thus, the time taken for one person to do the
work may not be the same as that for others and may or may not be 'reasonable' anyway. The
purpose of rating is to adjust the actual time to a standardized basic time that is appropriate
and at a defined level of performance. Rating is on a scale with 100 as its standard rating.

Basic time
Basic time is the standardised time for carrying out an element of work at standard rating.

Steps in Time study
   1. Define and document the standard method.
   2. Divide the task into work elements.
   3. Time the work elements to obtain the observed time for the task.
   4. Evaluate the worker’s pace relative to standard performance (performance rating), to
       determine the normal time.
   5. Apply an allowance to the normal time to compute the standard time.

Application
Time study is often used when
   • there are repetitive work cycles of short to long duration,
   • wide variety of dissimilar work is performed, or
   • process control elements constitute a part of the cycle.

 03. Explain inventory management in independent demand items

                                                                                              5

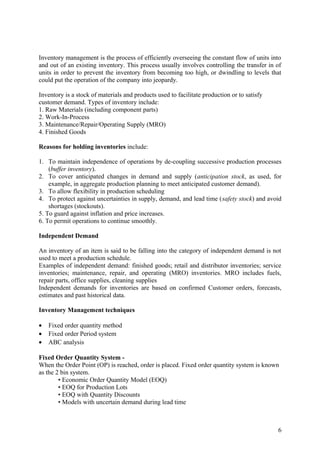

Inventory management is the process of efficiently overseeing the constant flow of units into
and out of an existing inventory. This process usually involves controlling the transfer in of
units in order to prevent the inventory from becoming too high, or dwindling to levels that
could put the operation of the company into jeopardy.

Inventory is a stock of materials and products used to facilitate production or to satisfy
customer demand. Types of inventory include:
1. Raw Materials (including component parts)
2. Work-In-Process
3. Maintenance/Repair/Operating Supply (MRO)
4. Finished Goods

Reasons for holding inventories include:

1. To maintain independence of operations by de-coupling successive production processes
    (buffer inventory).
2. To cover anticipated changes in demand and supply (anticipation stock, as used, for
    example, in aggregate production planning to meet anticipated customer demand).
3. To allow flexibility in production scheduling
4. To protect against uncertainties in supply, demand, and lead time (safety stock) and avoid
    shortages (stockouts).
5. To guard against inflation and price increases.
6. To permit operations to continue smoothly.

Independent Demand

An inventory of an item is said to be falling into the category of independent demand is not
used to meet a production schedule.
Examples of independent demand: finished goods; retail and distributor inventories; service
inventories; maintenance, repair, and operating (MRO) inventories. MRO includes fuels,
repair parts, office supplies, cleaning supplies
Independent demands for inventories are based on confirmed Customer orders, forecasts,
estimates and past historical data.

Inventory Management techniques

•   Fixed order quantity method
•   Fixed order Period system
•   ABC analysis

Fixed Order Quantity System -
When the Order Point (OP) is reached, order is placed. Fixed order quantity system is known
as the 2 bin system.
        • Economic Order Quantity Model (EOQ)
        • EOQ for Production Lots
        • EOQ with Quantity Discounts
        • Models with uncertain demand during lead time

                                                                                             6

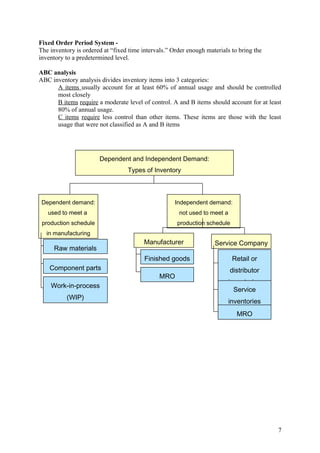

Fixed Order Period System -
The inventory is ordered at “fixed time intervals.” Order enough materials to bring the
inventory to a predetermined level.

ABC analysis
ABC inventory analysis divides inventory items into 3 categories:
      A items usually account for at least 60% of annual usage and should be controlled
      most closely
      B items require a moderate level of control. A and B items should account for at least
      80% of annual usage.
      C items require less control than other items. These items are those with the least
      usage that were not classified as A and B items

                       Dependent and Independent Demand:
                                  Types of Inventory

 Dependent demand:                                   Independent demand:
   used to meet a                                     not used to meet a
 production schedule                                  production schedule
   in manufacturing
                                         Manufacturer               Service Company
     Raw materials
                                         Finished goods                     Retail or
    Component parts                                                        distributor
                                               MRO
                                                                           inventories
    Work-in-process
                                                                             Service
          (WIP)
                                                                           inventories
                                                                             MRO

                                                                                          7
04. Explain in inventory management in dependent demand items

If the demand for inventory of an item is dependant upon another item, such demands are
categorized as dependant demand.

Raw materials and component inventories are dependant upon the demand for Finished
Goods and hence can be called as Dependant demand inventories.

Managing Raw Material Inventories is far more complicated than managing Finished Goods
Inventory. This involves analyzing and co-coordinating delivery capacity, lead times and
delivery schedules of all raw material suppliers, coupled with the logistical processes and
transit timelines involved in transportation and warehousing of raw materials before they are
ready to be supplied to the production shop floor. Raw material management also involves
periodic review of the inventory holding, inventory counting and audits, followed by detailed
analysis of the reports leading to financial and management decisions. The questions required
to be answered in inventory management are:
         How much quantity of materials should be ordered?
         When the order is to be placed?

                                      Finished                           Independent
                                      product                            Demand

                     Component 1                 Raw material 1

                                                                       Dependent
                     Component 2                 Raw material 2        Demand

                                                 Raw material 3

Inventory Management techniques

•    Master production schedule (MPS)
•    Material requirements planning (MRP)
•    MRP II
•    Just in Time (JIT)

Master production schedule (MPS)

                                                                                           8
A master production schedule (MPS) is a plan in respect of production, staffing, inventory,
etc. to produce individual commodities in each time period. Time-phased plan specifying
how many and when the firm plans to build each end item.

                Aggregate Plan
               (product groups)

                     MPS
                 (specific items)

The MPS translates the business plan, including forecast demand, into a production plan
using planned orders in a true multi-level optional component scheduling environment. Using
MPS helps avoid shortages, costly expediting, last minute scheduling, and inefficient
allocation of resources. Working with MPS allows businesses to consolidate planned parts,
produce master schedules and forecasts for any level of the Bill of Material (BOM) for any
type of part.
Example for mater production schedule for product A
Demand management                                             Dates
                                     2/5/12      3/5/12   4/5/12       5/5/12    7/5/12
Monthly demand for product A                                  4000
Working days in month                                           23
MPS daily demand for product A 174               174      174          174       174

MPS issues:
  • Width of the time bucket
  • Planning horizon
  • Rolling plan
  • Time fencing (frozen, moderately firm or flexible)
  • Schedule freezing

Material requirements planning (MRP)

            INPUTS                                         OUTPUTS

          Service parts                                    Inventory
          order forecast                                   transaction data

          Inventory
          status file               Materials               Order changes
                                    requirement          Planned order
                                    planning (MRP)       schedule
          Master
          production
          schedule                                               Planning reports
                                                           Performance report
          Bills of                                       Exception
          materials file                                 reports

                                                                                         9

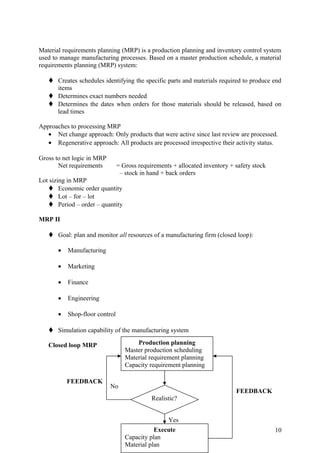

Material requirements planning (MRP) is a production planning and inventory control system
used to manage manufacturing processes. Based on a master production schedule, a material
requirements planning (MRP) system:

    Creates schedules identifying the specific parts and materials required to produce end
     items
    Determines exact numbers needed
    Determines the dates when orders for those materials should be released, based on
     lead times

Approaches to processing MRP
   • Net change approach: Only products that were active since last review are processed.
   • Regenerative approach: All products are processed irrespective their activity status.

Gross to net logic in MRP
       Net requirements         = Gross requirements + allocated inventory + safety stock
                                 – stock in hand + back orders
Lot sizing in MRP
    Economic order quantity
    Lot – for – lot
    Period – order – quantity

MRP II

    Goal: plan and monitor all resources of a manufacturing firm (closed loop):

       •   Manufacturing

       •   Marketing

       •   Finance

       •   Engineering

       •   Shop-floor control

    Simulation capability of the manufacturing system

   Closed loop MRP                     Production planning
                                   Master production scheduling
                                   Material requirement planning
                                   Capacity requirement planning

           FEEDBACK
                            No
                                                                             FEEDBACK
                                             Realistic?

                                                  Yes
                                              Execute                                       10
                                   Capacity plan
                                   Material plan

Just in Time
Just-in-time (JIT) purchasing is the purchase of goods or materials such that a delivery
immediately precedes demand or use. Companies moving toward JIT purchasing argue that
the cost of carrying inventories (in EOQ model) has been dramatically underestimated in the
past. The cost of placing a purchase order (in EOQ model) is also being re-evaluated.

Three factors are causing sizable reduction in the cost of placing a purchase order
1. Companies increasingly are establishing long-run purchasing arrangements.
2. Companies are using electronic links, such as the Internet, to place purchase orders
3. Companies are increasing the use of purchase order cards

Just-in-time (JIT) production systems take a “demand pull” approach in which goods are only
manufactured to satisfy customer orders.

Major features
1. Organizing production in manufacturing cells
2. Hiring and retaining multi-skilled workers
3. Emphasizing total quality management
4. Reducing manufacturing lead time and setup time
5. Building strong supplier relationships

                                                                                          11
05. Write short note on EOQ

Economic order quantity (EOQ) is the order quantity that minimizes total inventory holding
costs and ordering costs. It is one of the oldest classical production scheduling models. The
purpose of the EOQ model is to find that quantity to be ordered which minimizes the total
variable costs of inventory. Total variable costs are usually computed on an annual basis and
include two components, the costs of ordering and cost of holding the inventory.

Annual ordering cost is the number of orders placed times the marginal or incremental cost
incurred per order. This incremental cost includes several components such as the costs of
preparing the purchase order, paying the vendor's invoice, and inspecting and handling the
material when it arrives. It is difficult to estimate these components precisely. The EOQ is
not very much sensitive to errors in inputs.

The holding costs used in the EOQ should also be marginal in nature. Holding costs include
insurance, taxes, and storage charges, such as depreciation or the cost of leasing a
warehouse. The holding cost also includes the risk that inventory will spoil or become
obsolete before it can be used. Annual holding costs are usually computed as a fraction of
average inventory value.

EOQ applies only when demand for a product is constant over the year and each new order is
delivered in full when inventory reaches zero. There is a fixed cost for each order placed,
regardless of the number of units ordered. There is also a cost for each unit held in storage,
sometimes expressed as a percentage of the purchase cost of the item.

The optimal number of units to order is to be determined so that we minimize the total cost
associated with the purchase, delivery and storage of the product. The required parameters to
the solution are the total demand for the year, the purchase cost for each item, the fixed cost
to place the order and the storage cost for each item per year

                                                          Total cost
         Annual cost
                                                          Holding cost

                                                        Ordering cost
                                       EOQ              Order quantity

                 Total Cost = purchase cost + ordering cost + holding cost

Underlying assumptions
  1. The ordering cost is constant.
  2. The rate of demand is known, and spread evenly throughout the year.
  3. The lead time is fixed.

                                                                                            12
4. The purchase price of the item is constant i.e. no discount is available
   5. The replenishment is made instantaneously; the whole batch is delivered at once.
   6. Only one product is involved.

EOQ Formula

                     Total Cost = purchase cost + ordering cost + holding cost

Purchase cost: This is the variable cost of goods
Ordering cost: This is the cost of placing orders
Holding cost: the average quantity in stock (between fully replenished and empty) is Q/2

   D=     Annual demand (units)                    Total cost =    D C + S x (D/Q) + (Q/2) x I x C
   C=     Cost per unit ($)
   Q=     Order quantity (units)
   S=     Fixed Cost per order ($)                 Take the 1st derivative:
   I =    Holding cost (%)
   H=     Holding cost ($) = I x C                 d(TC)/d(Q) =     (I x C) / 2 - (D x S) / Q²

                                                   To optimize: set d(TC)/d(Q) = 0

 Number of Orders        =D/Q                                     DS/ Q² = IC / 2
 Ordering costs ($)      = S x (D / Q)
                                                                  EQ²/DS = 2 / IC
 Average inventory
               units     = Q/2                                    Q²= (DS x 2 )/ IC
               ($)       = (Q / 2) x C
 Cost to carry
 average inventory       = (Q / 2) x I x C
 Holding cost ($)        = (Q /2) x H

 Purchase cost ($)       =DC

EOQ is the function of annual demand (D), cost per order (S) and holding cost (H or IC)

                                                                                             13

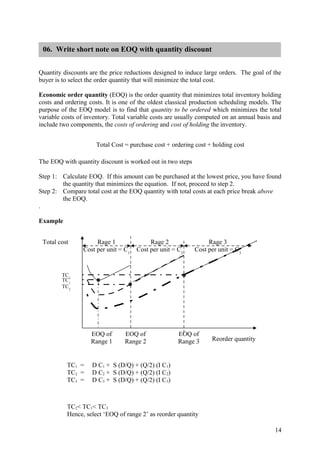

06. Write short note on EOQ with quantity discount

Quantity discounts are the price reductions designed to induce large orders. The goal of the
buyer is to select the order quantity that will minimize the total cost.

Economic order quantity (EOQ) is the order quantity that minimizes total inventory holding
costs and ordering costs. It is one of the oldest classical production scheduling models. The
purpose of the EOQ model is to find that quantity to be ordered which minimizes the total
variable costs of inventory. Total variable costs are usually computed on an annual basis and
include two components, the costs of ordering and cost of holding the inventory.

                      Total Cost = purchase cost + ordering cost + holding cost

The EOQ with quantity discount is worked out in two steps

Step 1: Calculate EOQ. If this amount can be purchased at the lowest price, you have found
        the quantity that minimizes the equation. If not, proceed to step 2.
Step 2: Compare total cost at the EOQ quantity with total costs at each price break above
        the EOQ.
.

Example

 Total cost           Rage 1               Rage 2                Rage 3
                 Cost per unit = C1   Cost per unit = C2    Cost per unit = C3

        TC3
        TC1
        TC2

                    EOQ of       EOQ of               EOQ of
                    Range 1      Range 2              Range 3     Reorder quantity

          TC1 =     D C1 + S (D/Q) + (Q/2) (I C1)
          TC2 =     D C2 + S (D/Q) + (Q/2) (I C2)
          TC3 =     D C3 + S (D/Q) + (Q/2) (I C3)

          TC2< TC1< TC3
          Hence, select ‘EOQ of range 2’ as reorder quantity

                                                                                          14

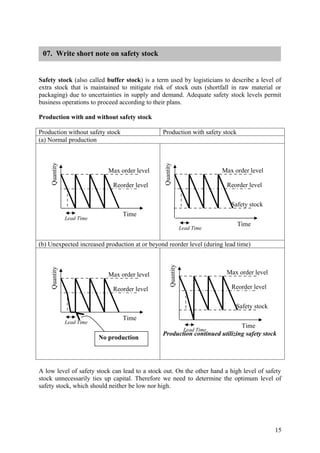

07. Write short note on safety stock

Safety stock (also called buffer stock) is a term used by logisticians to describe a level of
extra stock that is maintained to mitigate risk of stock outs (shortfall in raw material or
packaging) due to uncertainties in supply and demand. Adequate safety stock levels permit
business operations to proceed according to their plans.

Production with and without safety stock

Production without safety stock                 Production with safety stock
(a) Normal production
    Quantity

                              Max order level   Quantity                    Max order level

                               Reorder level                                 Reorder level

                                                                               Safety stock
                                   Time
               Lead Time
                                                                                 Time
                                                                Lead Time

(b) Unexpected increased production at or beyond reorder level (during lead time)
                                                     Quantity
    Quantity

                              Max order level                                Max order level

                               Reorder level                                   Reorder level

                                                                                 Safety stock
                                   Time
               Lead Time
                                                                             Time
                                                       Lead Time
                                                Production continued utilizing safety stock
                           No production

A low level of safety stock can lead to a stock out. On the other hand a high level of safety
stock unnecessarily ties up capital. Therefore we need to determine the optimum level of
safety stock, which should neither be low nor high.

                                                                                                15

Cost of safety stock

Safety stock involves two types of costs:
    1. Carrying cost of safety stock (CC)
    2. Stock out cost (SC)
Carrying cost of safety stock is inversely proportional to stock out cost. Research shows that
the total cost of safety stock is minimum only when
                  Carrying cost of safety stock = stock out cost

Reducing safety stock

Safety stock is used as a buffer to protect organizations from stock outs caused by inaccurate
planning or poor schedule adherence by suppliers. As such, its cost (in both material and
management) is often seen as a drain on financial resources that results in reduction
initiatives. In addition, time sensitive goods such as food, drink, and other perishable items
could spoil and go to waste if held as safety stock for too long. Various methods exist to
reduce safety stock; these include better use of technology, increased collaboration with
suppliers, and more accurate forecasting. In a lean supply environment, lead times are
reduced, which can help minimize safety stock levels thus reducing the likelihood and impact
of stock outs. Due to the cost of safety stock, many organizations opt for a service level led
safety stock calculation; for example, a 95% service level could result in stock outs, but is at
a level that is satisfactory to the company. The lower the service level, the lower the
requirement for safety stock.

                                                                                             16

08. Write short note on MRP (material requirement planning)

Material Requirements Planning (MRP) is a computer-based production planning and
inventory control system. MRP is concerned with both production scheduling and inventory
control. It is a material control system that attempts to keep adequate inventory levels to
assure that required materials are available when needed. MRP is applicable in situations of
multiple items with complex bills of materials. MRP is not useful for job shops or for
continuous processes that are tightly linked.

The major objectives of an MRP system are:
1. Ensure the availability of materials, components, and products for planned production and
   for customer delivery.
2. Maintain the lowest possible level of inventory
3. Plan manufacturing activities, delivery schedules, and purchasing activities.

MRP is especially suited to manufacturing settings where the demand of many of the
components and subassemblies depend on the demands of items that face external demands.
Demand for end items is independent. In contrast, demand for components used to
manufacture end items depend on the demands for the end items. The distinctions between
independent and dependent demands are important in classifying inventory items and in
developing systems to manage items within each demand classification.

The three major inputs of an MRP system are the master production schedule, the product
structure records, and the inventory status records. Without these basic inputs the MRP
system cannot function. The demand for end items is scheduled over a number of time
periods and recorded on a master production schedule (MPS). The master production
schedule expresses how much of each item is wanted and when it is wanted. The MPS is
developed from forecasts and customer orders for end items, safety stock requirements, and
internal orders. MRP takes the master schedule for end items and translates it into individual
time-phased component requirements. The product structure records, also known as bill of
material records (BOM), contain information on every item or assembly required to produce
end items. Information on each item, such as part number, description, quantity per assembly,
next higher assembly, lead times, and quantity per end item, must be available.

The inventory status records contain the status of all items in inventory, including on hand
inventory and scheduled receipts. These records must be kept up to date, with each receipt,
dis-bursement, or withdrawal documented to maintain record integrity. MRP will determine
from the master production schedule and the product structure records the gross component
requirements; the gross component requirements will be reduced by the available inventory
as indicated in the inventory status records.

Dealing with Uncertainty in MRP

There are several sources of uncertainty that we have ignored so far. These include
uncertainty in the quantity demanded (forecast errors) and the quantity supplied (yield
losses), and uncertainty in the timing of demand and the timing of supply (random lead
times). Many MRP systems cope with uncertainty by inflating lead times (inducing safety
time), by expediting orders, and by shifting priorities of shop and vendor orders. Another

                                                                                           17

way of protecting against uncertainty is to carry safety stock for end items with random
demand, and to carry safety stock of items produced at bottleneck operations.

Shortcomings of MRP

Capacity
MRP expects the lead time to be constant regardless of how much work has been released
into the Production system, so it is implicitly assuming infinite capacity.        This can
create problems when production levels are at or near capacity. One way to address this
problem is to make sure that the MPS is capacity feasible. Rough-cut capacity planning
(RCCP) attempts to do this by checking the capacity of a few critical resources.     RCCP
makes use of the bill of resources (BOR) for each item on the MPS. The BOR specifies the
number of hours required at each critical resource to build a particular end item and its
components, and then aggregates the number of hours required at each critical resource over
the end items in the MPS. RCCP then checks whether the available resources are enough to
cover the MPS on each time bucket. Notice that RCCP does not perform time offsets, so the
calculation of the number of hours required has to be done with time buckets that are large
enough so that parts and their components can all be completed within a single time bucket.
This usually makes RCCP an optimistic estimation of what can be done. Advanced MRP
systems provide more detailed capacity analysis proposing alternative production schedules
when the current plan is not feasible.

Long Lead Times
There are many pressures to increase planned lead times in an MRP system. MRP
uses constant lead times when, in fact, actual lead times vary considerably. To
compensate, planners typically choose pessimistic estimates. Long lead times lead to large
work-in-process (WIP) inventories.

Nervousness
MRP is typically applied in a rolling horizon basis. As customer orders firm up, and forecasts
become better, a new MPS is fed to MRP which produces updated planned order releases that
may be very different form the original. Even small changes in the MPS can result in large
changes in planned order releases. A small decrease in demand causes a formerly feasible
MRP plan to become infeasible.

                                                                                          18
09. Explain in detail production planning and control process

Production Planning is a process to develop tactical plans based on setting the overall level
of manufacturing output (production plan) and other activities to best satisfy the current
planned levels of sales (sales plan or forecasts), while meeting general business objectives of
profitability, productivity, competitive customer lead times, and so on, as expressed in the
overall business plan. The sales and production capabilities are compared, and a business
strategy that includes a sales plan, a production plan, budgets, pro forma financial statements,
and supporting plans for materials and workforce requirements, and so on, is developed. One
of its primary purposes is to establish production rates that will achieve management’s
objective of satisfying customer demand by maintaining, raising, or lowering inventories or
backlogs, while usually attempting to keep the workforce relatively stable. Because this plan
affects many company functions, it is normally prepared with information from marketing
and coordinated with the functions of manufacturing, sales, engineering, finance, materials,
and so on.

Advanced Planning and Scheduling (APS)
APS is the techniques that deal with analysis and planning of logistics and manufacturing
during short, intermediate and long-term time periods. APS describes any computer program
that uses advanced mathematical algorithms or logic to perform optimization or simulation on
finite capacity scheduling, sourcing, capital planning, resource planning, forecasting, demand
management, and others. These techniques simultaneously consider a range of constraints
and business rules to provide real-time planning and scheduling, decision support, available-
to-promise, and capable-to-promise capabilities. APS often generates and evaluates multiple
scenarios. Management then selects one scenario to use as the “official plan.”

Components of APS

   •   Demand Planning,
   •   Production Planning,
   •   Production Scheduling,
   •   Distribution Planning, and
   •   Transportation Planning.

Production planning is the function of establishing an overall level of output, called the
production plan. The process also includes any other activities needed to satisfy current
planned levels of sales, while meeting the firm's general objectives regarding profit,
productivity, lead times, and customer satisfaction, as expressed in the overall business plan.

The production schedule is derived from the production plan; it is a plan that authorized the
operations function to produce a certain quantity of an item within a specified time frame. In
a large firm, the production schedule is drawn in the production planning department.

                                                                                             19
10. Explain in detail MPS (master production scheduling)

A Master Production Schedule or MPS is the plan that a company has developed for
production, inventory, staffing, etc. It sets the quantity of each end item to be completed in
each week of a short-range planning horizon. A Master Production Schedule is the master of
all schedules. It is a plan for future production of end items.

Process in MPS system

            INPUTS                                                    OUTPUTS
     Forecast Demand
     Production Costs                                       Amounts to be Produced
     Inventory Costs                                        Staffing Levels
     Customer Orders                                        Quantity Available to Promise
     Inventory Levels                    MPS                Projected Available Balance
     Supply
     Lot Size
     Production Lead Time
     Capacity

The Master Production Schedule gives production, planning, purchasing, and top
management the information needed to plan and control the manufacturing operation. The
application ties overall business planning and forecasting to detail operations through the
Master Production Schedule. The Master Production Schedule will drive detailed material
and production requirements in the Material Requirements Planning module.

The master production schedule (MPS) is a link between the firm’s broad strategies and
tactical plans that enables the firm to achieve its goals. The MPS provides essential
information for functional areas such as operations, marketing, and finance. In this
supplement, we discuss the master production scheduling process, the need for functional
coordination, the way to develop an MPS, the information that an MPS provides to assist in
negotiating delivery dates, and the managerial considerations for establishing and stabilizing
the MPS.

By using several variables as inputs the MPS will generate a set of outputs used for decision
making. Inputs may include forecast demand, production costs, inventory costs, customer
orders, inventory levels, supply, lot size, production lead time, and capacity. Inputs may be
automatically generated by an ERP system that links a sales department with a production
department. For instance, when the sales department records a sale, the forecast demand
may be automatically shifted to meet the new demand. Inputs may also be inputted
manually from forecasts that have also been calculated manually. Outputs may include
amounts to be produced, staffing levels, quantity available to promise, and projected
available balance. Outputs may be used to create a Material Requirements Planning (MRP)
schedule.

                                                                                             20
11. Explain in detail short term scheduling process and techniques

Scheduling is an important tool for manufacturing and engineering, where it can have a
major impact on the productivity of a process. In manufacturing, the purpose of scheduling
is to minimize the production time and costs, by telling a production facility when to make,
with which staff, and on which equipment. Production scheduling aims to maximize the
efficiency of the operation and reduce costs.

Production scheduling tools greatly outperform older manual scheduling methods. These
provide the production scheduler with powerful graphical interfaces which can be used to
visually optimize real-time work loads in various stages of production, and pattern
recognition allows the software to automatically create scheduling opportunities which
might not be apparent without this view into the data. For example, an airline might wish to
minimize the number of airport gates required for its aircraft, in order to reduce costs, and
scheduling software can allow the planners to see how this can be done, by analyzing time
tables, aircraft usage, or the flow of passengers.

Short term scheduling concerns with the allocation of CPU time to processes in order to
meet some pre-defined system performance objectives. The definition of these objectives
(scheduling policy) is an overall system design issue, and determines the ``character'' of the
operating system from the user's (i.e. the buyer's) point of view, giving rise to the traditional
distinctions among ``multi-purpose, time shared'', ``batch production'', ``real-time'' systems,
and so on.

The main types of scheduling process and techniques include:
      Work centre loading
      Job sequencing

Work centre loading

Work centre loading is the assignment of jobs to work or processing centers. The operation
managers assign the job to work centres so that cost, idle time or completion is kept to
minimum. The forms of work centre loading are
      Oriented to capacity
      Assign the specific job to work centres

Job sequencing

Job sequencing is the arrangement of task required to be carried out sequentially. Priority
rules for the job sequencing are derived based on the assumption that job setup cost and
time is independent of process time. Job time include setup and processing time. Priority
rules aim at minimizing completion time, number of jobs in a system and job lateness.
Rules establish maximum facility utilization.
                                      **************

                                                                                                21

Production & Operations Management

  • 1.
    Assignment on Production &Operations Management submitted by Harikrishnan S. Happy V.S. Honey V.S. Job Thomas Yasser Bukari Group II Semester – 4 MBA (PT) 2012 submitted to Dr. Manoj Edward SCHOOL OF MANAGEMENT STUDIES Cochin University of Science and Technology Cochin, Kerala PIN 682022
  • 2.
  • 3.
    01. Explain indetail work / method study Work Study is the systematic examination of the methods of carrying on activities so as to improve the effective use of resources and to set up standards of performance for the activities being carried out. Method Work Higher study measurement productivity Work study Method study is the collection of techniques used to examine work - what is done and how it is done - so that there is systematic analysis of all the elements, factors, resources and relationships affecting the efficiency and effectiveness of the work being studied. Human factors influencing work study Managemen t Work study specialist Supervisors Workers Work study and the Management Importance of management must be established Gaining the management support Make the management feel that it is not their fault. Make the management understand the purpose and techniques of work study. Work Study and the Supervisor The importance of the supervisor: Supervisor is the person mostly affected by work study. Work study is a personal challenge for supervisor. Fear of taking away the responsibilities influences the work study. Work Study and the Worker Work study improves industrial relations: Workers feel that the management cares for them. Workers discover that there are managers who highly understand their job. The feeling of confidence in workers improves. 3
  • 4.
    Workers are moreable to carry out their jobs. Method study Select the job to be studied Record by collecting data or by direct observation Examine by Challenging purpose, place, sequence, and method of work Develop new methods drawing on contributions of those concerned Evaluate results of different alternative solutions Define new method and present it Install new method and train persons in applying it Maintain and establish control procedures Although this linear representation shows the underlying simplicity of method study, in practice the process is much more one of iteration around the above steps with each dominating at a different stage of the investigation. The process often starts with a quick, rough overview in which preliminary data are collected and examined, before subsequent passes provide and handle more comprehensive and more detailed data to obtain and analyze a more complete picture. 4
  • 5.
    02. Explain indetail time study Time study is a tested method of work measurement for setting standard time for carrying out a specified work. The aim of time study is to establish a time for a qualified worker to perform specified work under stated conditions and at a defined rate of working. Conditions in time study: • the practitioner (observer) must be fully qualified to carry out Time Study, • the person performing the task must be fully trained and experienced in the work, • the work must be clearly defined and the method of doing the work must be effective • the working conditions must be clearly defined Essentials for establishing a basic time for specified work are rating and timing Timing The observer records the actual time taken to do the element or operation. This usually is in centiminutes (0.01 min.) and is recorded, using a stop-watch or computerized study board. Rating When someone is doing work his/her way of working will vary throughout the working period and will be different from others doing the same work. This is due to differing speeds of movement, effort, dexterity and consistency. Thus, the time taken for one person to do the work may not be the same as that for others and may or may not be 'reasonable' anyway. The purpose of rating is to adjust the actual time to a standardized basic time that is appropriate and at a defined level of performance. Rating is on a scale with 100 as its standard rating. Basic time Basic time is the standardised time for carrying out an element of work at standard rating. Steps in Time study 1. Define and document the standard method. 2. Divide the task into work elements. 3. Time the work elements to obtain the observed time for the task. 4. Evaluate the worker’s pace relative to standard performance (performance rating), to determine the normal time. 5. Apply an allowance to the normal time to compute the standard time. Application Time study is often used when • there are repetitive work cycles of short to long duration, • wide variety of dissimilar work is performed, or • process control elements constitute a part of the cycle. 03. Explain inventory management in independent demand items 5
  • 6.
    Inventory management isthe process of efficiently overseeing the constant flow of units into and out of an existing inventory. This process usually involves controlling the transfer in of units in order to prevent the inventory from becoming too high, or dwindling to levels that could put the operation of the company into jeopardy. Inventory is a stock of materials and products used to facilitate production or to satisfy customer demand. Types of inventory include: 1. Raw Materials (including component parts) 2. Work-In-Process 3. Maintenance/Repair/Operating Supply (MRO) 4. Finished Goods Reasons for holding inventories include: 1. To maintain independence of operations by de-coupling successive production processes (buffer inventory). 2. To cover anticipated changes in demand and supply (anticipation stock, as used, for example, in aggregate production planning to meet anticipated customer demand). 3. To allow flexibility in production scheduling 4. To protect against uncertainties in supply, demand, and lead time (safety stock) and avoid shortages (stockouts). 5. To guard against inflation and price increases. 6. To permit operations to continue smoothly. Independent Demand An inventory of an item is said to be falling into the category of independent demand is not used to meet a production schedule. Examples of independent demand: finished goods; retail and distributor inventories; service inventories; maintenance, repair, and operating (MRO) inventories. MRO includes fuels, repair parts, office supplies, cleaning supplies Independent demands for inventories are based on confirmed Customer orders, forecasts, estimates and past historical data. Inventory Management techniques • Fixed order quantity method • Fixed order Period system • ABC analysis Fixed Order Quantity System - When the Order Point (OP) is reached, order is placed. Fixed order quantity system is known as the 2 bin system. • Economic Order Quantity Model (EOQ) • EOQ for Production Lots • EOQ with Quantity Discounts • Models with uncertain demand during lead time 6
  • 7.
    Fixed Order PeriodSystem - The inventory is ordered at “fixed time intervals.” Order enough materials to bring the inventory to a predetermined level. ABC analysis ABC inventory analysis divides inventory items into 3 categories: A items usually account for at least 60% of annual usage and should be controlled most closely B items require a moderate level of control. A and B items should account for at least 80% of annual usage. C items require less control than other items. These items are those with the least usage that were not classified as A and B items Dependent and Independent Demand: Types of Inventory Dependent demand: Independent demand: used to meet a not used to meet a production schedule production schedule in manufacturing Manufacturer Service Company Raw materials Finished goods Retail or Component parts distributor MRO inventories Work-in-process Service (WIP) inventories MRO 7
  • 8.
    04. Explain ininventory management in dependent demand items If the demand for inventory of an item is dependant upon another item, such demands are categorized as dependant demand. Raw materials and component inventories are dependant upon the demand for Finished Goods and hence can be called as Dependant demand inventories. Managing Raw Material Inventories is far more complicated than managing Finished Goods Inventory. This involves analyzing and co-coordinating delivery capacity, lead times and delivery schedules of all raw material suppliers, coupled with the logistical processes and transit timelines involved in transportation and warehousing of raw materials before they are ready to be supplied to the production shop floor. Raw material management also involves periodic review of the inventory holding, inventory counting and audits, followed by detailed analysis of the reports leading to financial and management decisions. The questions required to be answered in inventory management are: How much quantity of materials should be ordered? When the order is to be placed? Finished Independent product Demand Component 1 Raw material 1 Dependent Component 2 Raw material 2 Demand Raw material 3 Inventory Management techniques • Master production schedule (MPS) • Material requirements planning (MRP) • MRP II • Just in Time (JIT) Master production schedule (MPS) 8
  • 9.
    A master productionschedule (MPS) is a plan in respect of production, staffing, inventory, etc. to produce individual commodities in each time period. Time-phased plan specifying how many and when the firm plans to build each end item. Aggregate Plan (product groups) MPS (specific items) The MPS translates the business plan, including forecast demand, into a production plan using planned orders in a true multi-level optional component scheduling environment. Using MPS helps avoid shortages, costly expediting, last minute scheduling, and inefficient allocation of resources. Working with MPS allows businesses to consolidate planned parts, produce master schedules and forecasts for any level of the Bill of Material (BOM) for any type of part. Example for mater production schedule for product A Demand management Dates 2/5/12 3/5/12 4/5/12 5/5/12 7/5/12 Monthly demand for product A 4000 Working days in month 23 MPS daily demand for product A 174 174 174 174 174 MPS issues: • Width of the time bucket • Planning horizon • Rolling plan • Time fencing (frozen, moderately firm or flexible) • Schedule freezing Material requirements planning (MRP) INPUTS OUTPUTS Service parts Inventory order forecast transaction data Inventory status file Materials Order changes requirement Planned order planning (MRP) schedule Master production schedule Planning reports Performance report Bills of Exception materials file reports 9
  • 10.
    Material requirements planning(MRP) is a production planning and inventory control system used to manage manufacturing processes. Based on a master production schedule, a material requirements planning (MRP) system:  Creates schedules identifying the specific parts and materials required to produce end items  Determines exact numbers needed  Determines the dates when orders for those materials should be released, based on lead times Approaches to processing MRP • Net change approach: Only products that were active since last review are processed. • Regenerative approach: All products are processed irrespective their activity status. Gross to net logic in MRP Net requirements = Gross requirements + allocated inventory + safety stock – stock in hand + back orders Lot sizing in MRP  Economic order quantity  Lot – for – lot  Period – order – quantity MRP II  Goal: plan and monitor all resources of a manufacturing firm (closed loop): • Manufacturing • Marketing • Finance • Engineering • Shop-floor control  Simulation capability of the manufacturing system Closed loop MRP Production planning Master production scheduling Material requirement planning Capacity requirement planning FEEDBACK No FEEDBACK Realistic? Yes Execute 10 Capacity plan Material plan
  • 11.
    Just in Time Just-in-time(JIT) purchasing is the purchase of goods or materials such that a delivery immediately precedes demand or use. Companies moving toward JIT purchasing argue that the cost of carrying inventories (in EOQ model) has been dramatically underestimated in the past. The cost of placing a purchase order (in EOQ model) is also being re-evaluated. Three factors are causing sizable reduction in the cost of placing a purchase order 1. Companies increasingly are establishing long-run purchasing arrangements. 2. Companies are using electronic links, such as the Internet, to place purchase orders 3. Companies are increasing the use of purchase order cards Just-in-time (JIT) production systems take a “demand pull” approach in which goods are only manufactured to satisfy customer orders. Major features 1. Organizing production in manufacturing cells 2. Hiring and retaining multi-skilled workers 3. Emphasizing total quality management 4. Reducing manufacturing lead time and setup time 5. Building strong supplier relationships 11
  • 12.
    05. Write shortnote on EOQ Economic order quantity (EOQ) is the order quantity that minimizes total inventory holding costs and ordering costs. It is one of the oldest classical production scheduling models. The purpose of the EOQ model is to find that quantity to be ordered which minimizes the total variable costs of inventory. Total variable costs are usually computed on an annual basis and include two components, the costs of ordering and cost of holding the inventory. Annual ordering cost is the number of orders placed times the marginal or incremental cost incurred per order. This incremental cost includes several components such as the costs of preparing the purchase order, paying the vendor's invoice, and inspecting and handling the material when it arrives. It is difficult to estimate these components precisely. The EOQ is not very much sensitive to errors in inputs. The holding costs used in the EOQ should also be marginal in nature. Holding costs include insurance, taxes, and storage charges, such as depreciation or the cost of leasing a warehouse. The holding cost also includes the risk that inventory will spoil or become obsolete before it can be used. Annual holding costs are usually computed as a fraction of average inventory value. EOQ applies only when demand for a product is constant over the year and each new order is delivered in full when inventory reaches zero. There is a fixed cost for each order placed, regardless of the number of units ordered. There is also a cost for each unit held in storage, sometimes expressed as a percentage of the purchase cost of the item. The optimal number of units to order is to be determined so that we minimize the total cost associated with the purchase, delivery and storage of the product. The required parameters to the solution are the total demand for the year, the purchase cost for each item, the fixed cost to place the order and the storage cost for each item per year Total cost Annual cost Holding cost Ordering cost EOQ Order quantity Total Cost = purchase cost + ordering cost + holding cost Underlying assumptions 1. The ordering cost is constant. 2. The rate of demand is known, and spread evenly throughout the year. 3. The lead time is fixed. 12
  • 13.
    4. The purchaseprice of the item is constant i.e. no discount is available 5. The replenishment is made instantaneously; the whole batch is delivered at once. 6. Only one product is involved. EOQ Formula Total Cost = purchase cost + ordering cost + holding cost Purchase cost: This is the variable cost of goods Ordering cost: This is the cost of placing orders Holding cost: the average quantity in stock (between fully replenished and empty) is Q/2 D= Annual demand (units) Total cost = D C + S x (D/Q) + (Q/2) x I x C C= Cost per unit ($) Q= Order quantity (units) S= Fixed Cost per order ($) Take the 1st derivative: I = Holding cost (%) H= Holding cost ($) = I x C d(TC)/d(Q) = (I x C) / 2 - (D x S) / Q² To optimize: set d(TC)/d(Q) = 0 Number of Orders =D/Q DS/ Q² = IC / 2 Ordering costs ($) = S x (D / Q) EQ²/DS = 2 / IC Average inventory units = Q/2 Q²= (DS x 2 )/ IC ($) = (Q / 2) x C Cost to carry average inventory = (Q / 2) x I x C Holding cost ($) = (Q /2) x H Purchase cost ($) =DC EOQ is the function of annual demand (D), cost per order (S) and holding cost (H or IC) 13
  • 14.
    06. Write shortnote on EOQ with quantity discount Quantity discounts are the price reductions designed to induce large orders. The goal of the buyer is to select the order quantity that will minimize the total cost. Economic order quantity (EOQ) is the order quantity that minimizes total inventory holding costs and ordering costs. It is one of the oldest classical production scheduling models. The purpose of the EOQ model is to find that quantity to be ordered which minimizes the total variable costs of inventory. Total variable costs are usually computed on an annual basis and include two components, the costs of ordering and cost of holding the inventory. Total Cost = purchase cost + ordering cost + holding cost The EOQ with quantity discount is worked out in two steps Step 1: Calculate EOQ. If this amount can be purchased at the lowest price, you have found the quantity that minimizes the equation. If not, proceed to step 2. Step 2: Compare total cost at the EOQ quantity with total costs at each price break above the EOQ. . Example Total cost Rage 1 Rage 2 Rage 3 Cost per unit = C1 Cost per unit = C2 Cost per unit = C3 TC3 TC1 TC2 EOQ of EOQ of EOQ of Range 1 Range 2 Range 3 Reorder quantity TC1 = D C1 + S (D/Q) + (Q/2) (I C1) TC2 = D C2 + S (D/Q) + (Q/2) (I C2) TC3 = D C3 + S (D/Q) + (Q/2) (I C3) TC2< TC1< TC3 Hence, select ‘EOQ of range 2’ as reorder quantity 14
  • 15.
    07. Write shortnote on safety stock Safety stock (also called buffer stock) is a term used by logisticians to describe a level of extra stock that is maintained to mitigate risk of stock outs (shortfall in raw material or packaging) due to uncertainties in supply and demand. Adequate safety stock levels permit business operations to proceed according to their plans. Production with and without safety stock Production without safety stock Production with safety stock (a) Normal production Quantity Max order level Quantity Max order level Reorder level Reorder level Safety stock Time Lead Time Time Lead Time (b) Unexpected increased production at or beyond reorder level (during lead time) Quantity Quantity Max order level Max order level Reorder level Reorder level Safety stock Time Lead Time Time Lead Time Production continued utilizing safety stock No production A low level of safety stock can lead to a stock out. On the other hand a high level of safety stock unnecessarily ties up capital. Therefore we need to determine the optimum level of safety stock, which should neither be low nor high. 15
  • 16.
    Cost of safetystock Safety stock involves two types of costs: 1. Carrying cost of safety stock (CC) 2. Stock out cost (SC) Carrying cost of safety stock is inversely proportional to stock out cost. Research shows that the total cost of safety stock is minimum only when Carrying cost of safety stock = stock out cost Reducing safety stock Safety stock is used as a buffer to protect organizations from stock outs caused by inaccurate planning or poor schedule adherence by suppliers. As such, its cost (in both material and management) is often seen as a drain on financial resources that results in reduction initiatives. In addition, time sensitive goods such as food, drink, and other perishable items could spoil and go to waste if held as safety stock for too long. Various methods exist to reduce safety stock; these include better use of technology, increased collaboration with suppliers, and more accurate forecasting. In a lean supply environment, lead times are reduced, which can help minimize safety stock levels thus reducing the likelihood and impact of stock outs. Due to the cost of safety stock, many organizations opt for a service level led safety stock calculation; for example, a 95% service level could result in stock outs, but is at a level that is satisfactory to the company. The lower the service level, the lower the requirement for safety stock. 16
  • 17.
    08. Write shortnote on MRP (material requirement planning) Material Requirements Planning (MRP) is a computer-based production planning and inventory control system. MRP is concerned with both production scheduling and inventory control. It is a material control system that attempts to keep adequate inventory levels to assure that required materials are available when needed. MRP is applicable in situations of multiple items with complex bills of materials. MRP is not useful for job shops or for continuous processes that are tightly linked. The major objectives of an MRP system are: 1. Ensure the availability of materials, components, and products for planned production and for customer delivery. 2. Maintain the lowest possible level of inventory 3. Plan manufacturing activities, delivery schedules, and purchasing activities. MRP is especially suited to manufacturing settings where the demand of many of the components and subassemblies depend on the demands of items that face external demands. Demand for end items is independent. In contrast, demand for components used to manufacture end items depend on the demands for the end items. The distinctions between independent and dependent demands are important in classifying inventory items and in developing systems to manage items within each demand classification. The three major inputs of an MRP system are the master production schedule, the product structure records, and the inventory status records. Without these basic inputs the MRP system cannot function. The demand for end items is scheduled over a number of time periods and recorded on a master production schedule (MPS). The master production schedule expresses how much of each item is wanted and when it is wanted. The MPS is developed from forecasts and customer orders for end items, safety stock requirements, and internal orders. MRP takes the master schedule for end items and translates it into individual time-phased component requirements. The product structure records, also known as bill of material records (BOM), contain information on every item or assembly required to produce end items. Information on each item, such as part number, description, quantity per assembly, next higher assembly, lead times, and quantity per end item, must be available. The inventory status records contain the status of all items in inventory, including on hand inventory and scheduled receipts. These records must be kept up to date, with each receipt, dis-bursement, or withdrawal documented to maintain record integrity. MRP will determine from the master production schedule and the product structure records the gross component requirements; the gross component requirements will be reduced by the available inventory as indicated in the inventory status records. Dealing with Uncertainty in MRP There are several sources of uncertainty that we have ignored so far. These include uncertainty in the quantity demanded (forecast errors) and the quantity supplied (yield losses), and uncertainty in the timing of demand and the timing of supply (random lead times). Many MRP systems cope with uncertainty by inflating lead times (inducing safety time), by expediting orders, and by shifting priorities of shop and vendor orders. Another 17
  • 18.
    way of protectingagainst uncertainty is to carry safety stock for end items with random demand, and to carry safety stock of items produced at bottleneck operations. Shortcomings of MRP Capacity MRP expects the lead time to be constant regardless of how much work has been released into the Production system, so it is implicitly assuming infinite capacity. This can create problems when production levels are at or near capacity. One way to address this problem is to make sure that the MPS is capacity feasible. Rough-cut capacity planning (RCCP) attempts to do this by checking the capacity of a few critical resources. RCCP makes use of the bill of resources (BOR) for each item on the MPS. The BOR specifies the number of hours required at each critical resource to build a particular end item and its components, and then aggregates the number of hours required at each critical resource over the end items in the MPS. RCCP then checks whether the available resources are enough to cover the MPS on each time bucket. Notice that RCCP does not perform time offsets, so the calculation of the number of hours required has to be done with time buckets that are large enough so that parts and their components can all be completed within a single time bucket. This usually makes RCCP an optimistic estimation of what can be done. Advanced MRP systems provide more detailed capacity analysis proposing alternative production schedules when the current plan is not feasible. Long Lead Times There are many pressures to increase planned lead times in an MRP system. MRP uses constant lead times when, in fact, actual lead times vary considerably. To compensate, planners typically choose pessimistic estimates. Long lead times lead to large work-in-process (WIP) inventories. Nervousness MRP is typically applied in a rolling horizon basis. As customer orders firm up, and forecasts become better, a new MPS is fed to MRP which produces updated planned order releases that may be very different form the original. Even small changes in the MPS can result in large changes in planned order releases. A small decrease in demand causes a formerly feasible MRP plan to become infeasible. 18
  • 19.
    09. Explain indetail production planning and control process Production Planning is a process to develop tactical plans based on setting the overall level of manufacturing output (production plan) and other activities to best satisfy the current planned levels of sales (sales plan or forecasts), while meeting general business objectives of profitability, productivity, competitive customer lead times, and so on, as expressed in the overall business plan. The sales and production capabilities are compared, and a business strategy that includes a sales plan, a production plan, budgets, pro forma financial statements, and supporting plans for materials and workforce requirements, and so on, is developed. One of its primary purposes is to establish production rates that will achieve management’s objective of satisfying customer demand by maintaining, raising, or lowering inventories or backlogs, while usually attempting to keep the workforce relatively stable. Because this plan affects many company functions, it is normally prepared with information from marketing and coordinated with the functions of manufacturing, sales, engineering, finance, materials, and so on. Advanced Planning and Scheduling (APS) APS is the techniques that deal with analysis and planning of logistics and manufacturing during short, intermediate and long-term time periods. APS describes any computer program that uses advanced mathematical algorithms or logic to perform optimization or simulation on finite capacity scheduling, sourcing, capital planning, resource planning, forecasting, demand management, and others. These techniques simultaneously consider a range of constraints and business rules to provide real-time planning and scheduling, decision support, available- to-promise, and capable-to-promise capabilities. APS often generates and evaluates multiple scenarios. Management then selects one scenario to use as the “official plan.” Components of APS • Demand Planning, • Production Planning, • Production Scheduling, • Distribution Planning, and • Transportation Planning. Production planning is the function of establishing an overall level of output, called the production plan. The process also includes any other activities needed to satisfy current planned levels of sales, while meeting the firm's general objectives regarding profit, productivity, lead times, and customer satisfaction, as expressed in the overall business plan. The production schedule is derived from the production plan; it is a plan that authorized the operations function to produce a certain quantity of an item within a specified time frame. In a large firm, the production schedule is drawn in the production planning department. 19
  • 20.
    10. Explain indetail MPS (master production scheduling) A Master Production Schedule or MPS is the plan that a company has developed for production, inventory, staffing, etc. It sets the quantity of each end item to be completed in each week of a short-range planning horizon. A Master Production Schedule is the master of all schedules. It is a plan for future production of end items. Process in MPS system INPUTS OUTPUTS Forecast Demand Production Costs Amounts to be Produced Inventory Costs Staffing Levels Customer Orders Quantity Available to Promise Inventory Levels MPS Projected Available Balance Supply Lot Size Production Lead Time Capacity The Master Production Schedule gives production, planning, purchasing, and top management the information needed to plan and control the manufacturing operation. The application ties overall business planning and forecasting to detail operations through the Master Production Schedule. The Master Production Schedule will drive detailed material and production requirements in the Material Requirements Planning module. The master production schedule (MPS) is a link between the firm’s broad strategies and tactical plans that enables the firm to achieve its goals. The MPS provides essential information for functional areas such as operations, marketing, and finance. In this supplement, we discuss the master production scheduling process, the need for functional coordination, the way to develop an MPS, the information that an MPS provides to assist in negotiating delivery dates, and the managerial considerations for establishing and stabilizing the MPS. By using several variables as inputs the MPS will generate a set of outputs used for decision making. Inputs may include forecast demand, production costs, inventory costs, customer orders, inventory levels, supply, lot size, production lead time, and capacity. Inputs may be automatically generated by an ERP system that links a sales department with a production department. For instance, when the sales department records a sale, the forecast demand may be automatically shifted to meet the new demand. Inputs may also be inputted manually from forecasts that have also been calculated manually. Outputs may include amounts to be produced, staffing levels, quantity available to promise, and projected available balance. Outputs may be used to create a Material Requirements Planning (MRP) schedule. 20
  • 21.
    11. Explain indetail short term scheduling process and techniques Scheduling is an important tool for manufacturing and engineering, where it can have a major impact on the productivity of a process. In manufacturing, the purpose of scheduling is to minimize the production time and costs, by telling a production facility when to make, with which staff, and on which equipment. Production scheduling aims to maximize the efficiency of the operation and reduce costs. Production scheduling tools greatly outperform older manual scheduling methods. These provide the production scheduler with powerful graphical interfaces which can be used to visually optimize real-time work loads in various stages of production, and pattern recognition allows the software to automatically create scheduling opportunities which might not be apparent without this view into the data. For example, an airline might wish to minimize the number of airport gates required for its aircraft, in order to reduce costs, and scheduling software can allow the planners to see how this can be done, by analyzing time tables, aircraft usage, or the flow of passengers. Short term scheduling concerns with the allocation of CPU time to processes in order to meet some pre-defined system performance objectives. The definition of these objectives (scheduling policy) is an overall system design issue, and determines the ``character'' of the operating system from the user's (i.e. the buyer's) point of view, giving rise to the traditional distinctions among ``multi-purpose, time shared'', ``batch production'', ``real-time'' systems, and so on. The main types of scheduling process and techniques include: Work centre loading Job sequencing Work centre loading Work centre loading is the assignment of jobs to work or processing centers. The operation managers assign the job to work centres so that cost, idle time or completion is kept to minimum. The forms of work centre loading are Oriented to capacity Assign the specific job to work centres Job sequencing Job sequencing is the arrangement of task required to be carried out sequentially. Priority rules for the job sequencing are derived based on the assumption that job setup cost and time is independent of process time. Job time include setup and processing time. Priority rules aim at minimizing completion time, number of jobs in a system and job lateness. Rules establish maximum facility utilization. ************** 21
