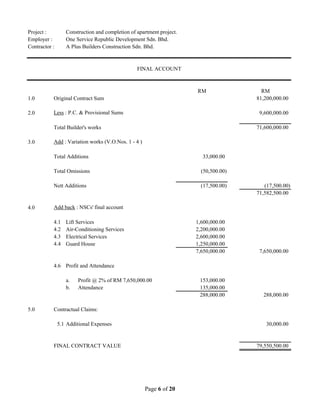

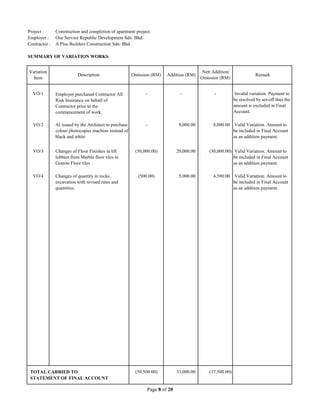

The contractor submitted a final account for an apartment construction project within the required timeframe. The final account was assessed and a final contract value of RM 79,550,500 was determined. Key adjustments included:

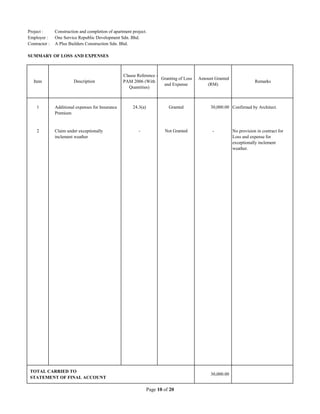

1) Approval of RM 30,000 for additional insurance premium due to employer-caused delay.

2) Rejection of RM 120,000 loss and expense claim for inclement weather, as this was not a relevant event under the contract.

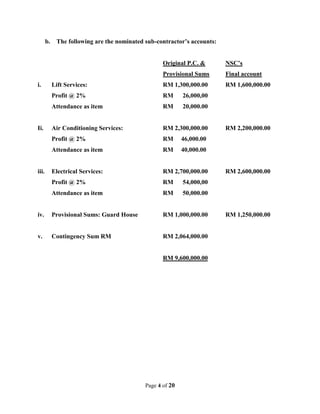

3) Inclusion of nominated subcontractors' final accounts totaling RM 7,650,000, along with 2% profit and attendance costs.
4) Granting of an extension of time but no additional payment for the inclement weather
