This document provides information and questions for a quantity surveying assignment on preparing the final account for an apartment construction project. It includes:

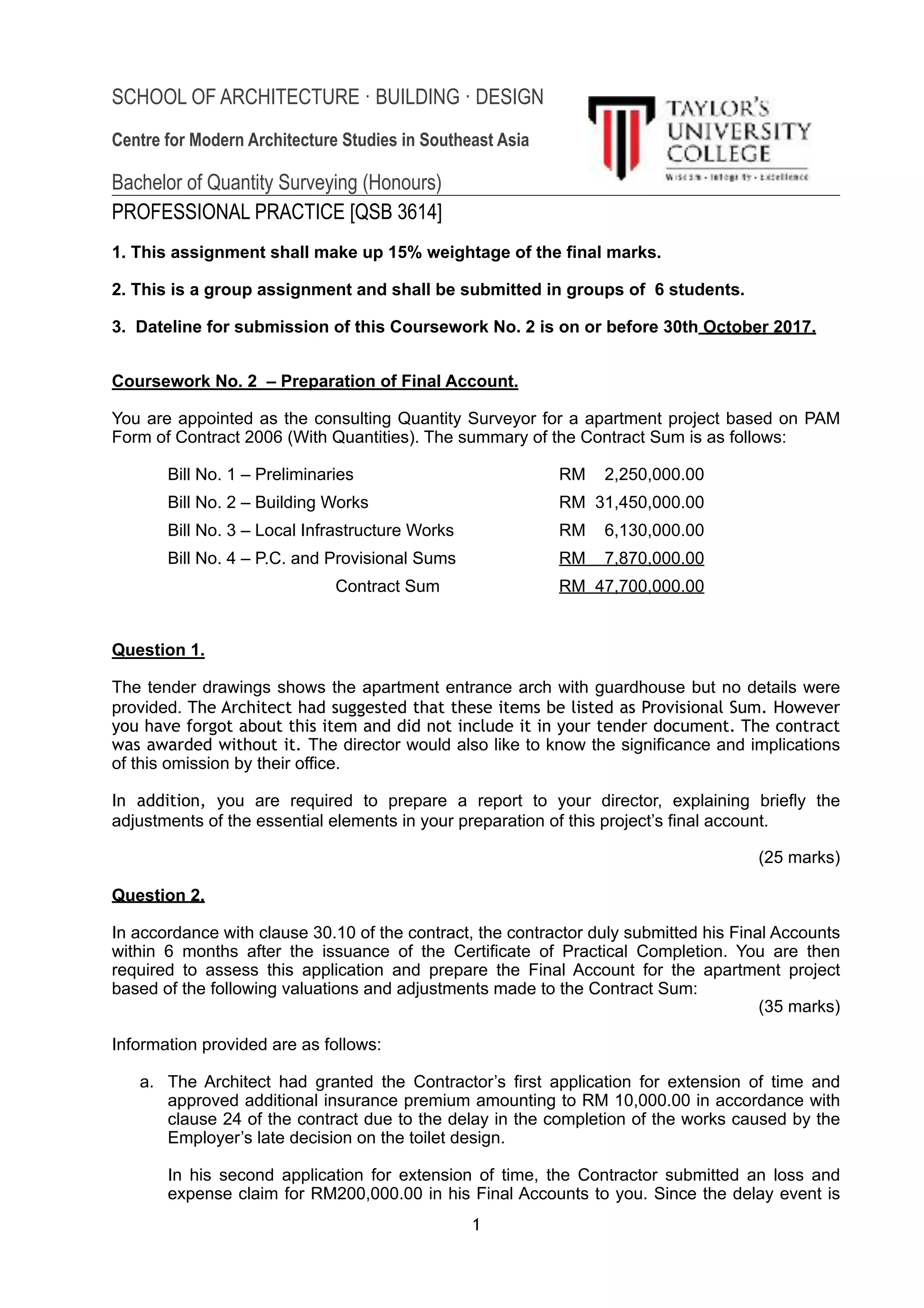

1) Background on the contract sum totaling RM 47.7 million and questions requiring analysis of issues like omitted items and their implications as well as adjustments to the final account.

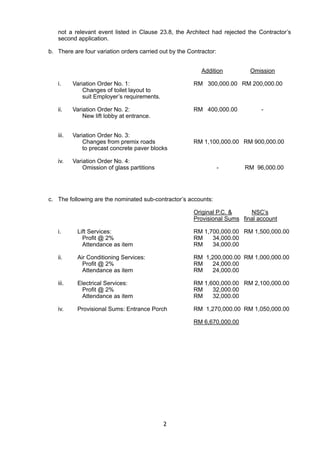

2) Information on extension of time, variation orders, nominated subcontractor accounts is provided to assess the contractor's final account application.

3) Explanations are requested on how various types of variations would be finalized and priced, such as a relocated door, omitted unpriced item, substitute work due to site constraints, and mistake in excavation rates.
