Honolulu Police Department
Operating Budget




           Fiscal Year
           2012-2013
FY 2012-2013 Budget Changes

                                                                  %
    Activity         FY 2012       FY 2013       $ Change
                                                                Change
Salaries          $196,278,529   $185,745,550   ($10,532,979)    (5.4)


Current Expense     36,167,665    38,071,141      1,903,476       5.3


Equipment             136,400         0             (136,400)    (100)


                  $232,582,594   $223,816,691   ($8,765,903)     (3.8)
    TOTAL

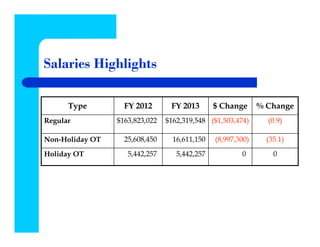

Salaries Highlights

      Type         FY 2012       FY 2013       $ Change      % Change
Regular          $163,823,022   $162,319,548 ($1,503,474)      (0.9)

Non-Holiday OT     25,608,450     16,611,150   (8,997,300)     (35.1)

Holiday OT          5,442,257      5,442,257           0         0

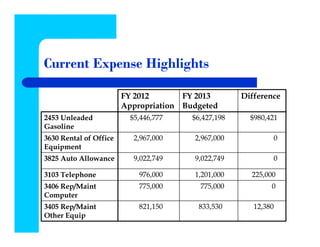

Current Expense Highlights

                        FY 2012       FY 2013        Difference
                        Appropriation Budgeted
2453 Unleaded             $5,446,777    $6,427,198     $980,421
Gasoline
3630 Rental of Office      2,967,000    2,967,000            0
Equipment
3825 Auto Allowance        9,022,749    9,022,749            0

3103 Telephone              976,000     1,201,000      225,000
3406 Rep/Maint              775,000       775,000            0
Computer
3405 Rep/Maint              821,150      833,530        12,380
Other Equip

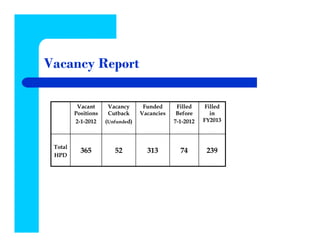

Vacancy Report

          Vacant      Vacancy      Funded      Filled     Filled
         Positions    Cutback     Vacancies    Before       in
         2-1-2012    (Unfunded)               7-1-2012   FY2013



 Total
           365          52          313         74        239
 HPD

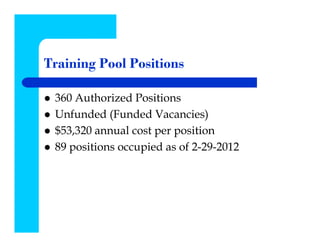

Training Pool Positions

 360 Authorized Positions
 Unfunded (Funded Vacancies)
 $53,320 annual cost per position
 89 positions occupied as of 2-29-2012

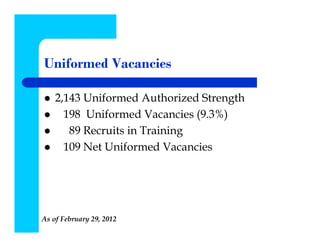

Uniformed Vacancies

    2,143 Uniformed Authorized Strength
      198 Uniformed Vacancies (9.3%)
       89 Recruits in Training
      109 Net Uniformed Vacancies




As of February 29, 2012

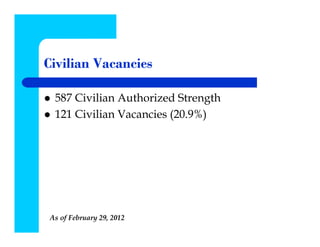

Civilian Vacancies

 587 Civilian Authorized Strength
 121 Civilian Vacancies (20.9%)




As of February 29, 2012

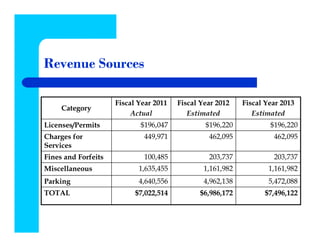

Revenue Sources

                     Fiscal Year 2011   Fiscal Year 2012    Fiscal Year 2013
     Category
                          Actual           Estimated           Estimated
Licenses/Permits            $196,047            $196,220            $196,220
Charges for                  449,971             462,095             462,095
Services
Fines and Forfeits           100,485             203,737             203,737
Miscellaneous               1,635,455           1,161,982           1,161,982
Parking                     4,640,556           4,962,138           5,472,088
TOTAL                      $7,022,514          $6,986,172         $7,496,122
Capital Improvement
Projects

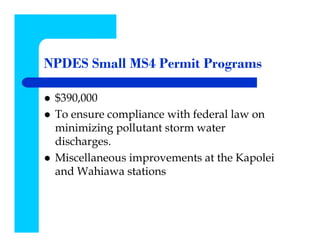

NPDES Small MS4 Permit Programs

 $390,000
 To ensure compliance with federal law on
 minimizing pollutant storm water
 discharges.
 Miscellaneous improvements at the Kapolei
 and Wahiawa stations

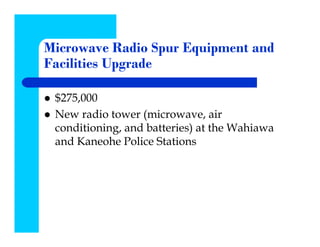

Microwave Radio Spur Equipment and
Facilities Upgrade

 $275,000
 New radio tower (microwave, air
 conditioning, and batteries) at the Wahiawa
 and Kaneohe Police Stations

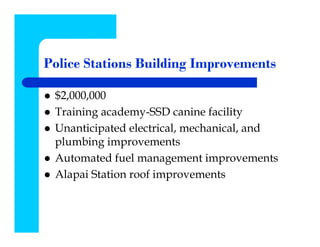

Police Stations Building Improvements

 $2,000,000
 Training academy-SSD canine facility
 Unanticipated electrical, mechanical, and
 plumbing improvements
 Automated fuel management improvements
 Alapai Station roof improvements

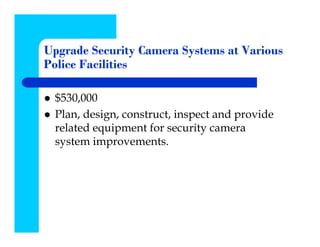

Upgrade Security Camera Systems at Various
Police Facilities

 $530,000
 Plan, design, construct, inspect and provide
 related equipment for security camera
 system improvements.

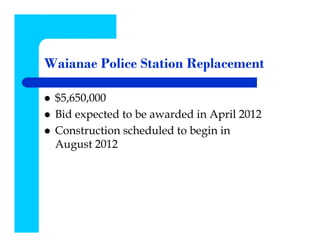

Waianae Police Station Replacement

 $5,650,000
 Bid expected to be awarded in April 2012
 Construction scheduled to begin in
 August 2012
Equipment Acquisition

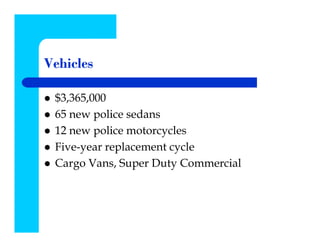

Vehicles

 $3,365,000
 65 new police sedans
 12 new police motorcycles
 Five-year replacement cycle
 Cargo Vans, Super Duty Commercial
