Discovering story points
@nadiazemskova

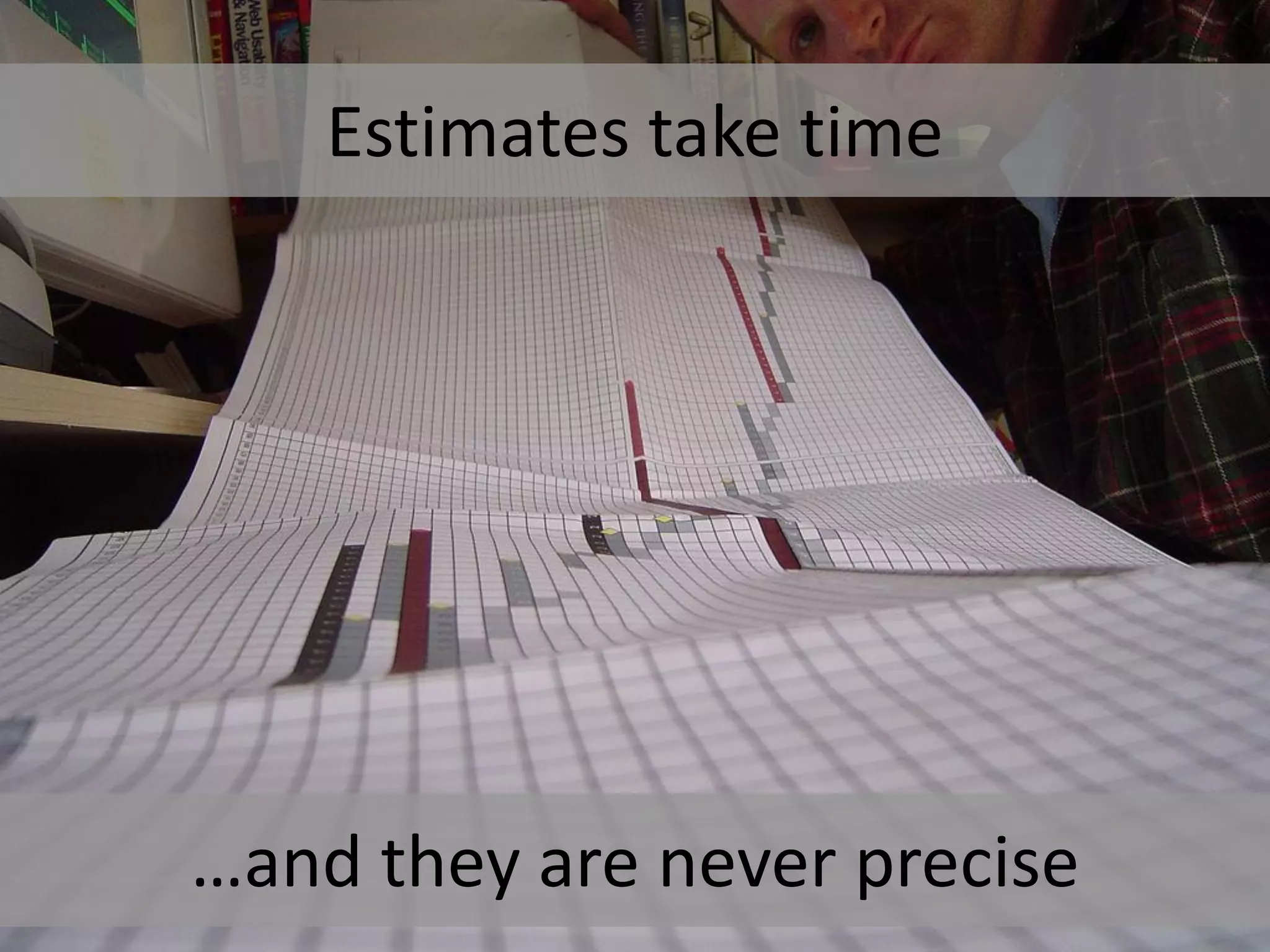

Estimates take time

…and they are never precise
Why estimate?
First there were hours
Hours are dependent on individual
Hours are dependent on specialty

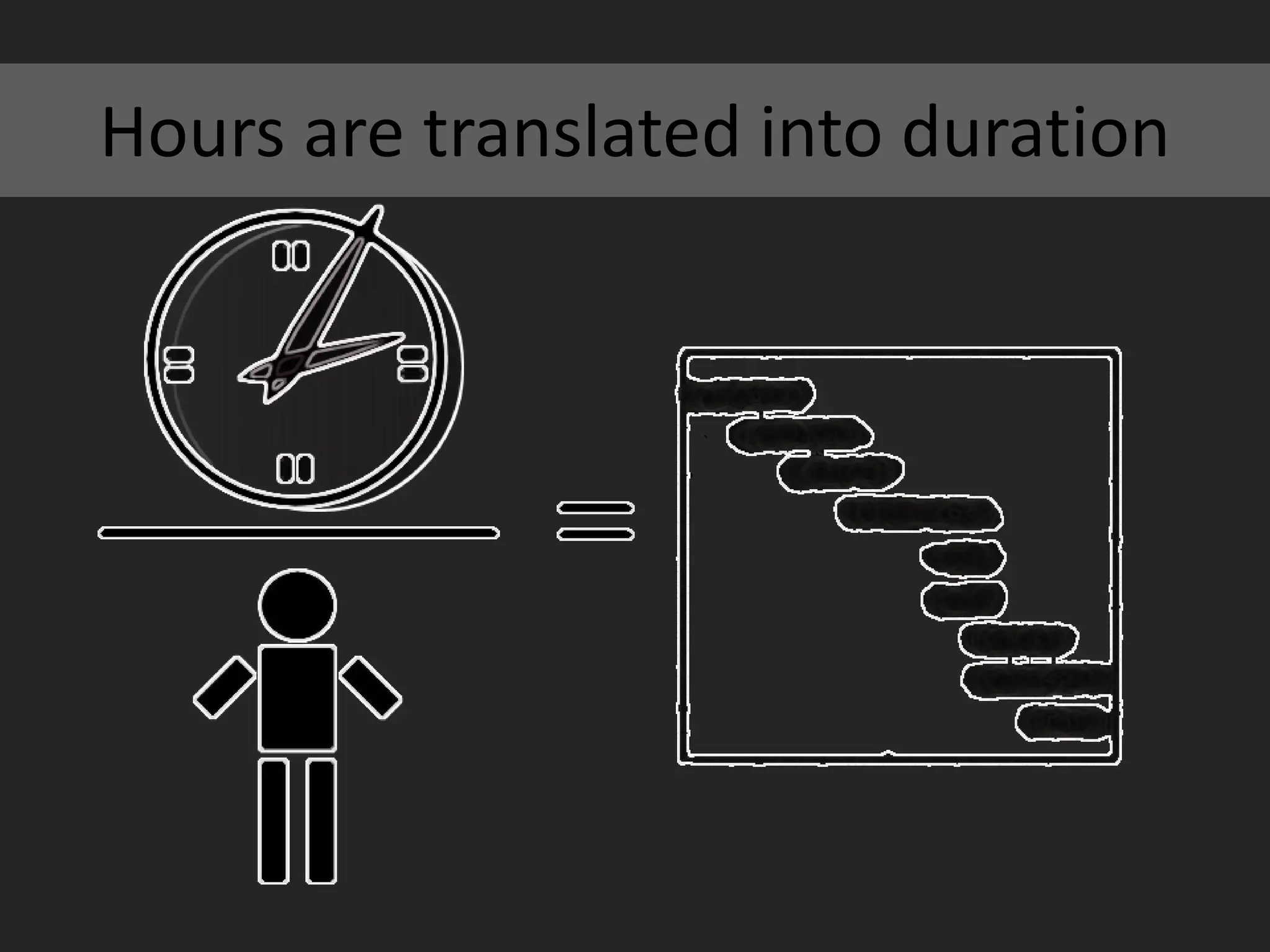

Hours are translated into duration

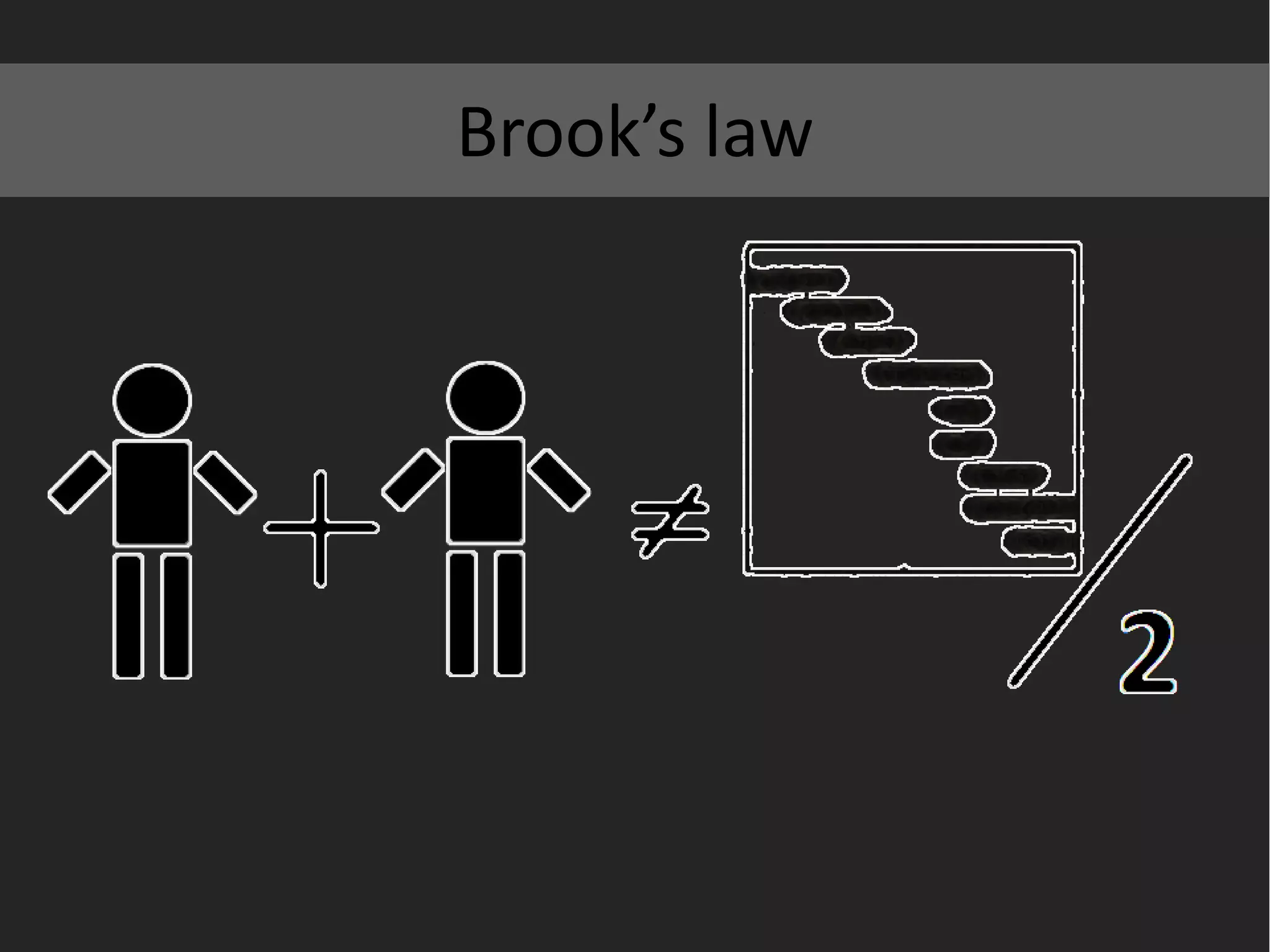

Brook’s law
Wishful thinking

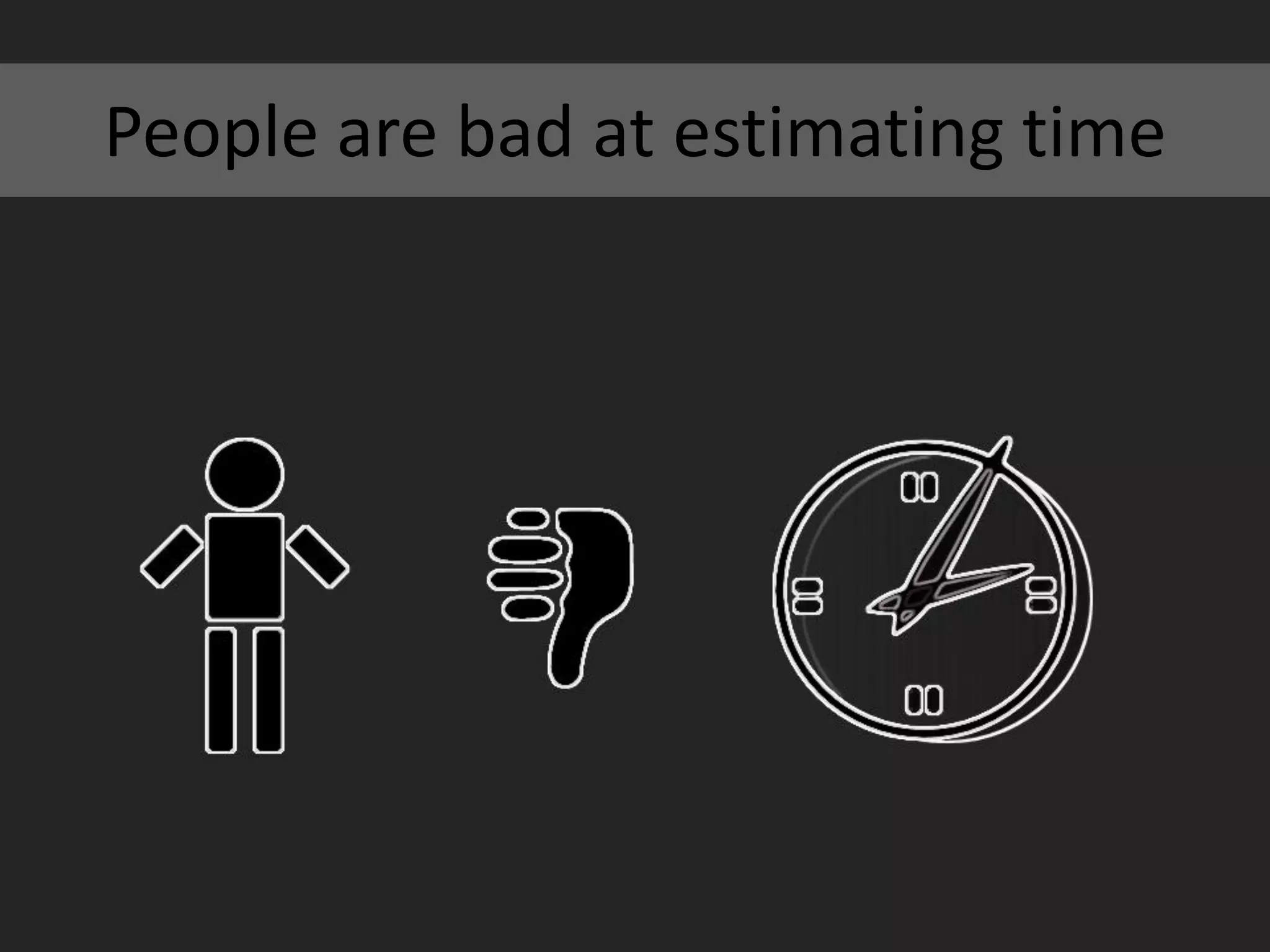

People are bad at estimating time

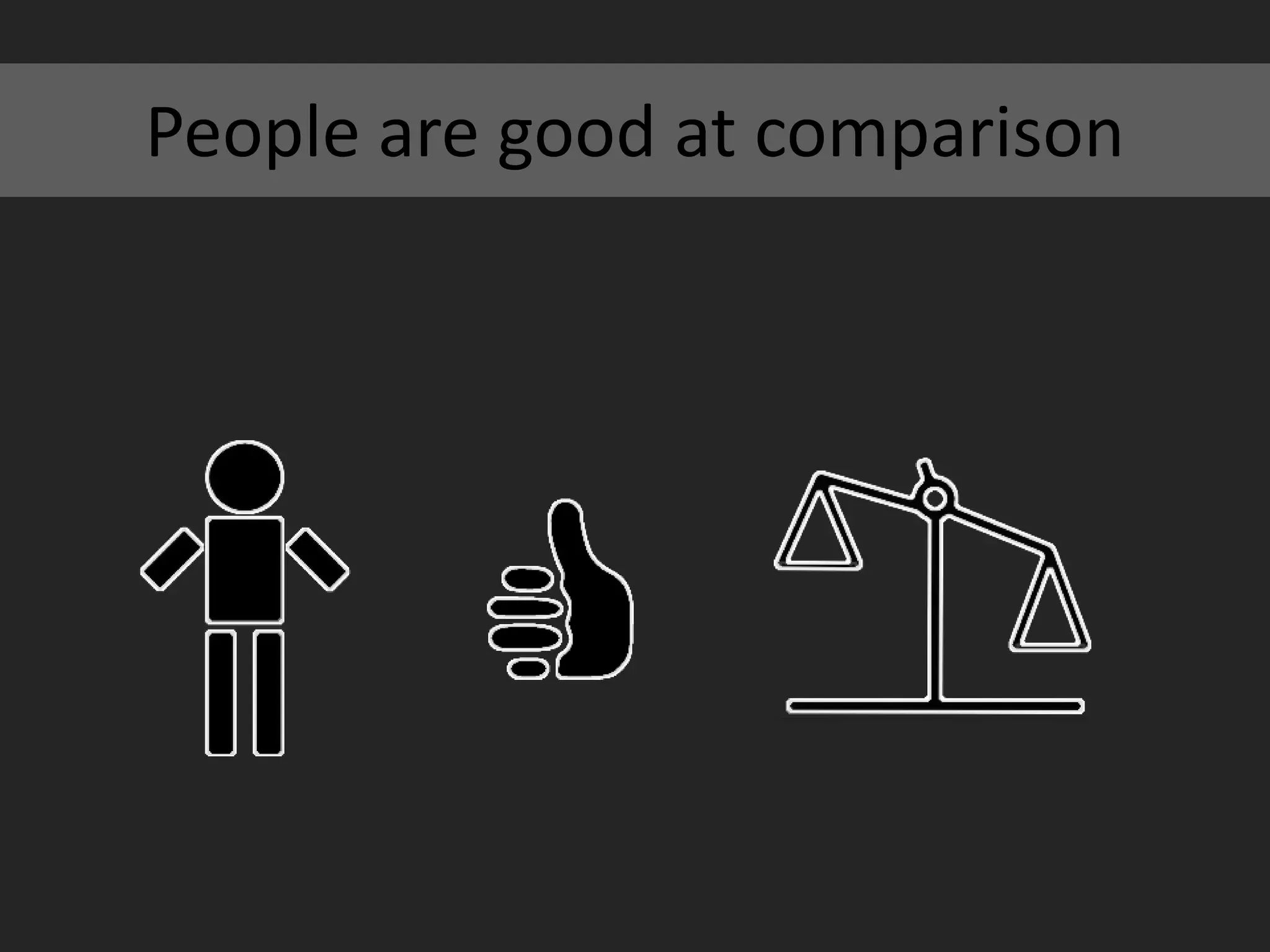

People are good at comparison
5
3
                          2
               1
Compare these buildings

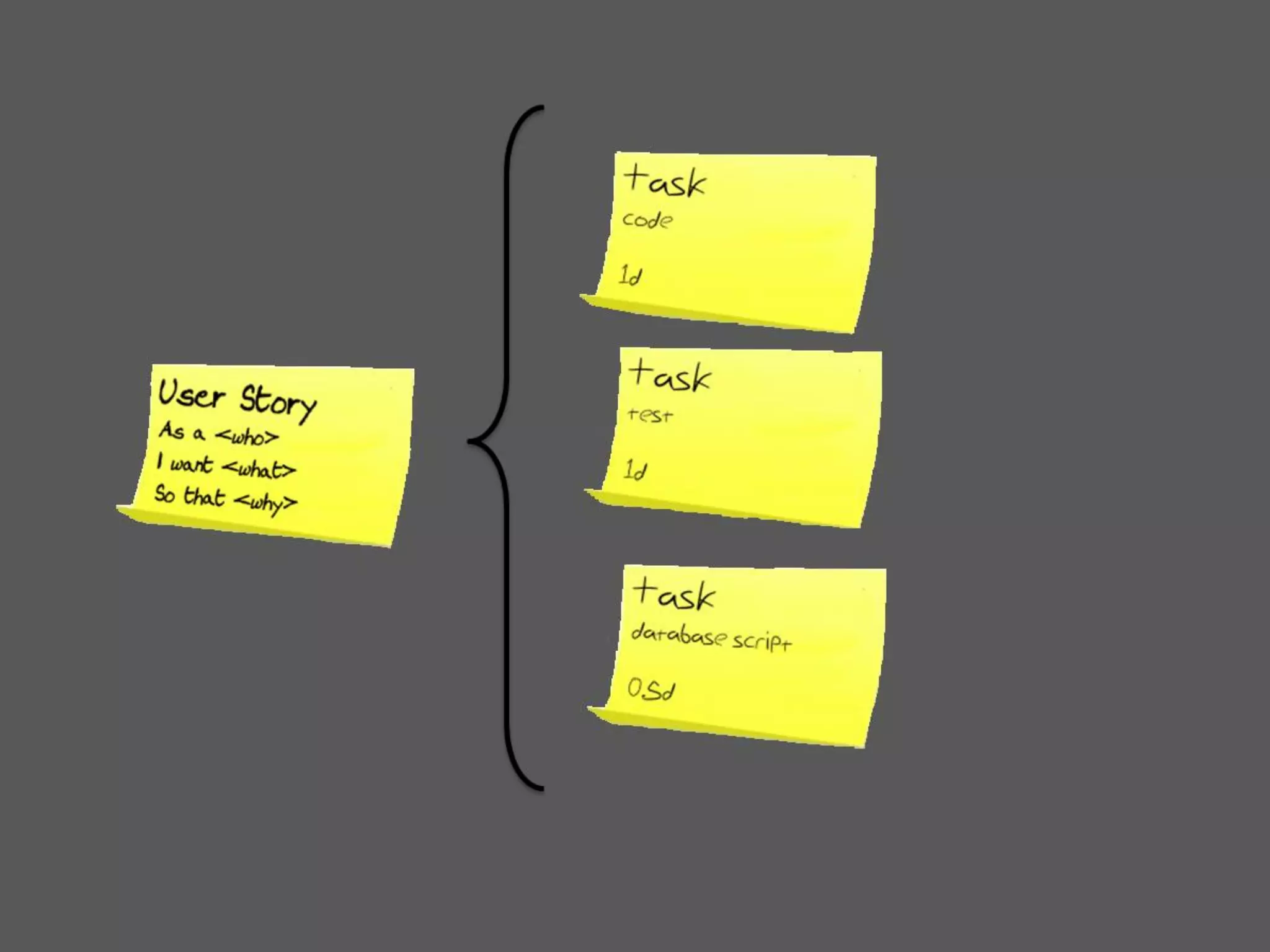

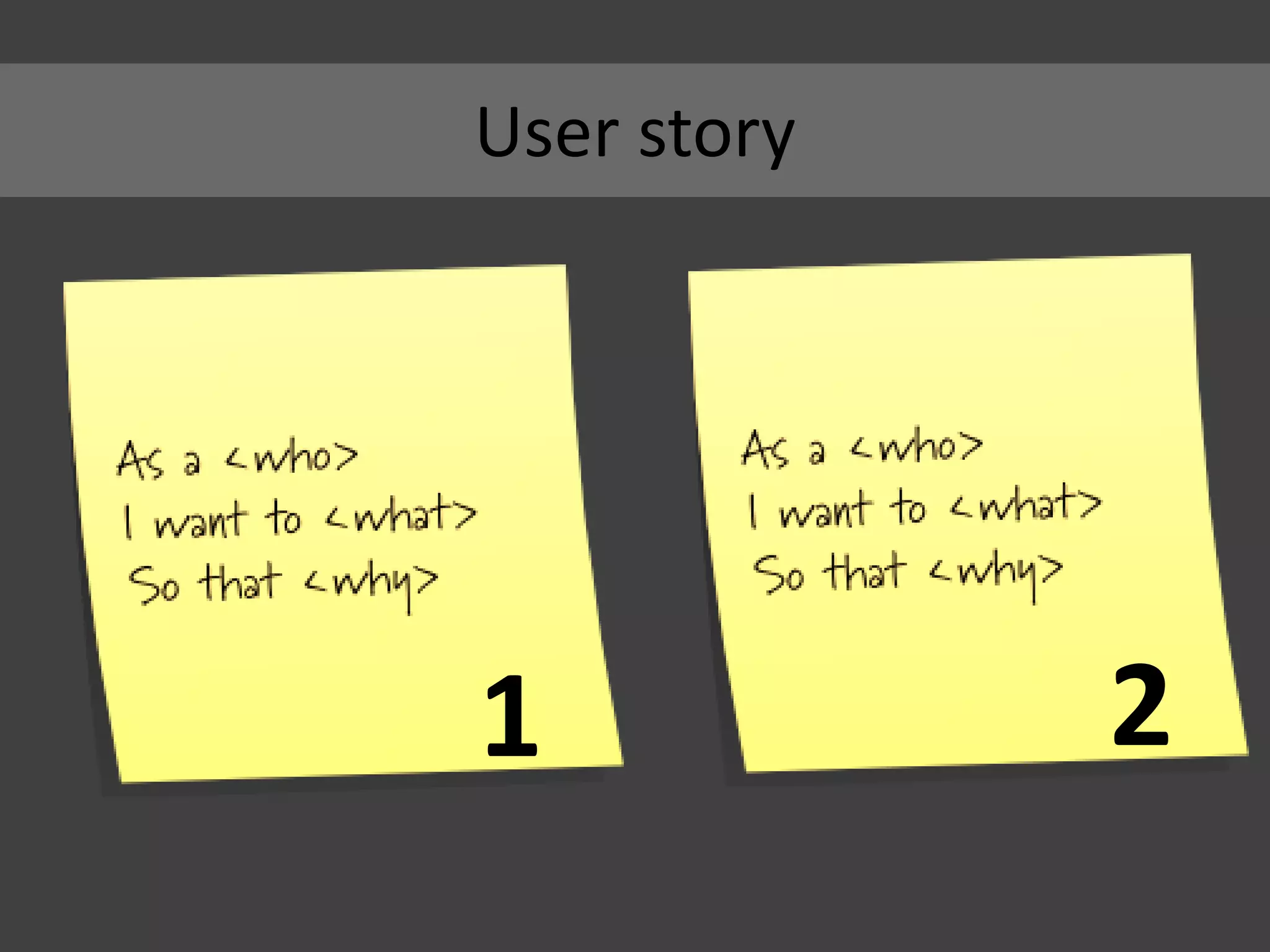

User story

1            2

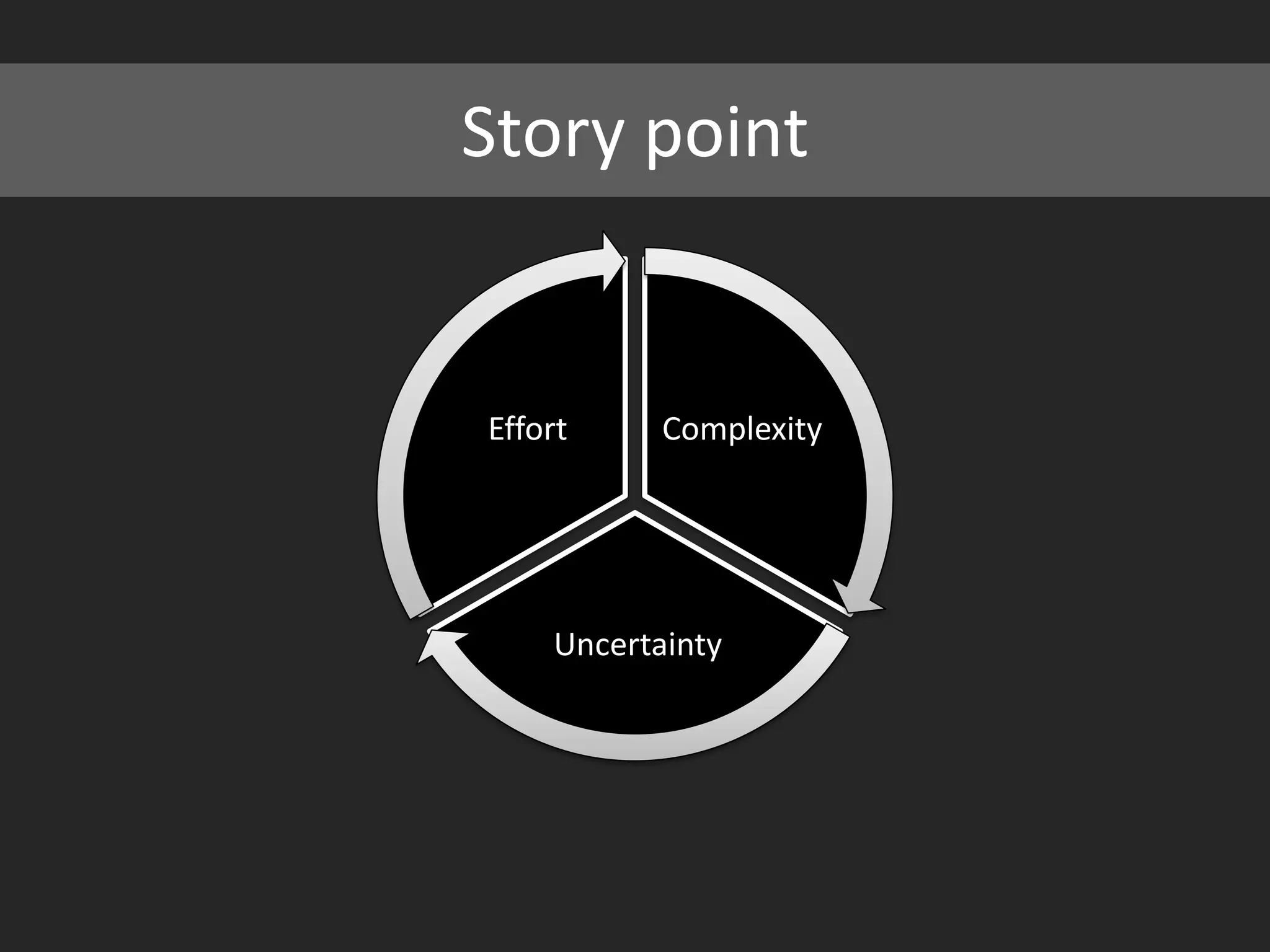

Story point

Effort     Complexity

    Uncertainty

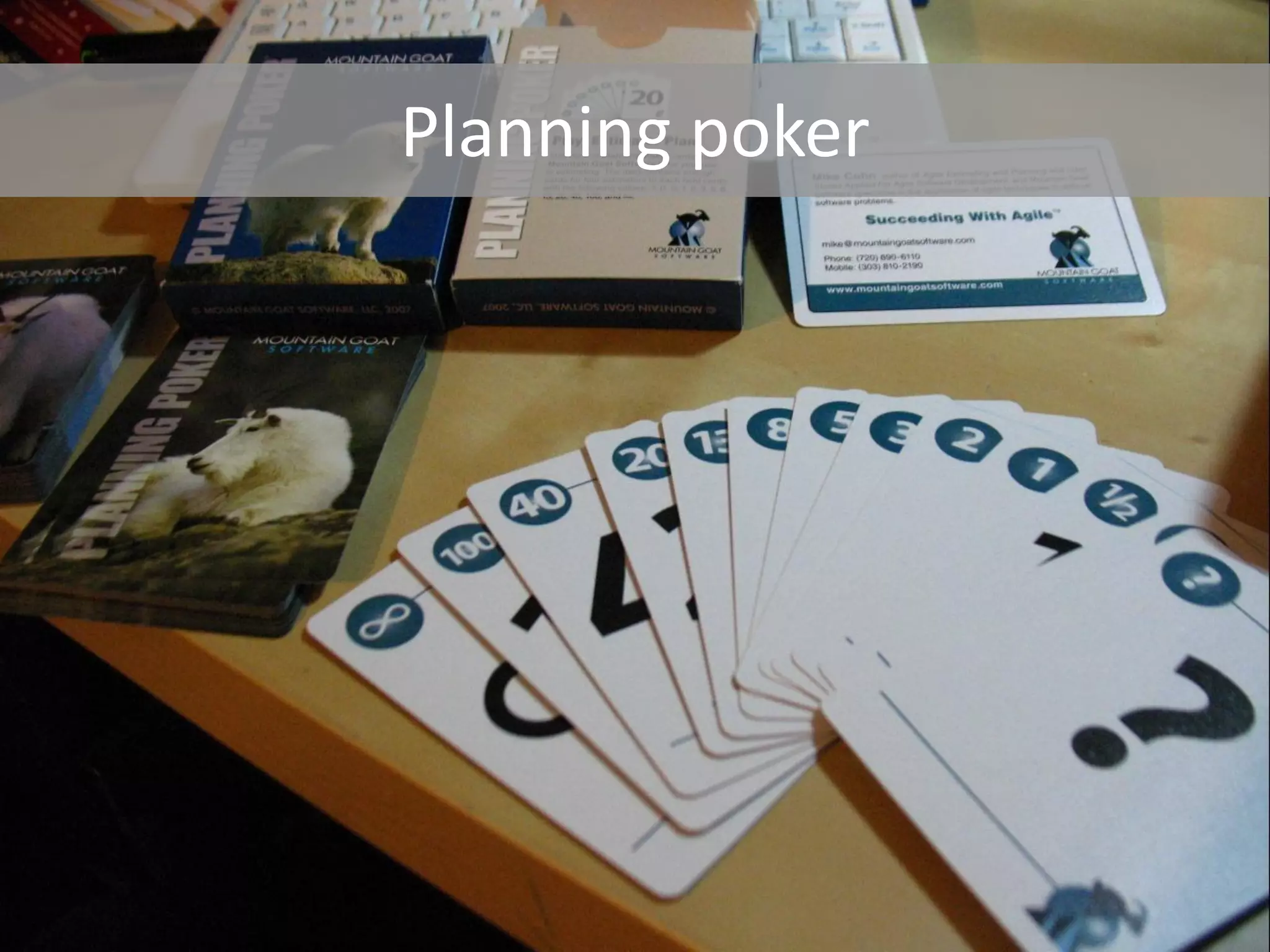

Planning poker

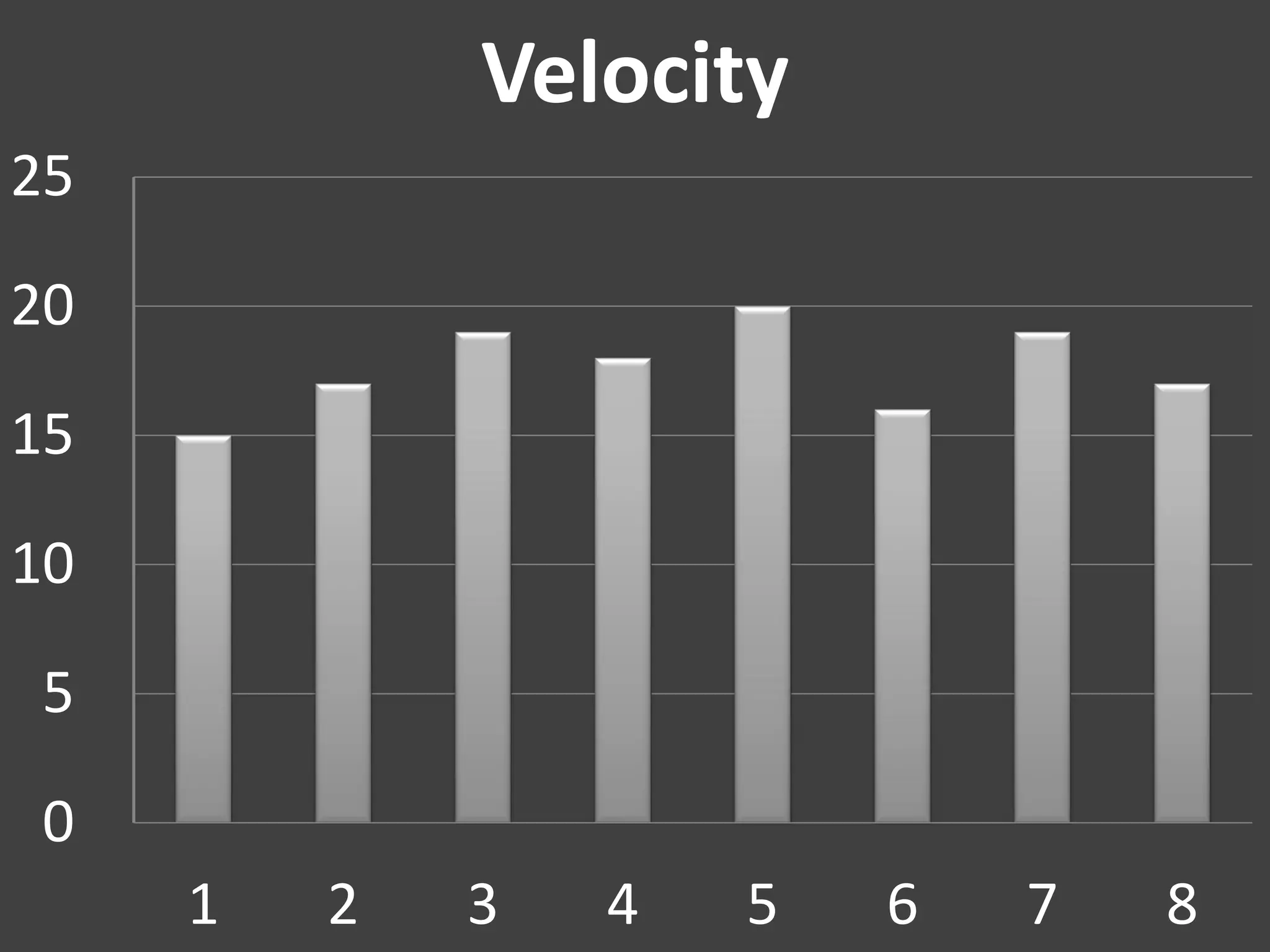

Velocity
25

20

15

10

5

0
     1   2   3   4   5   6   7   8

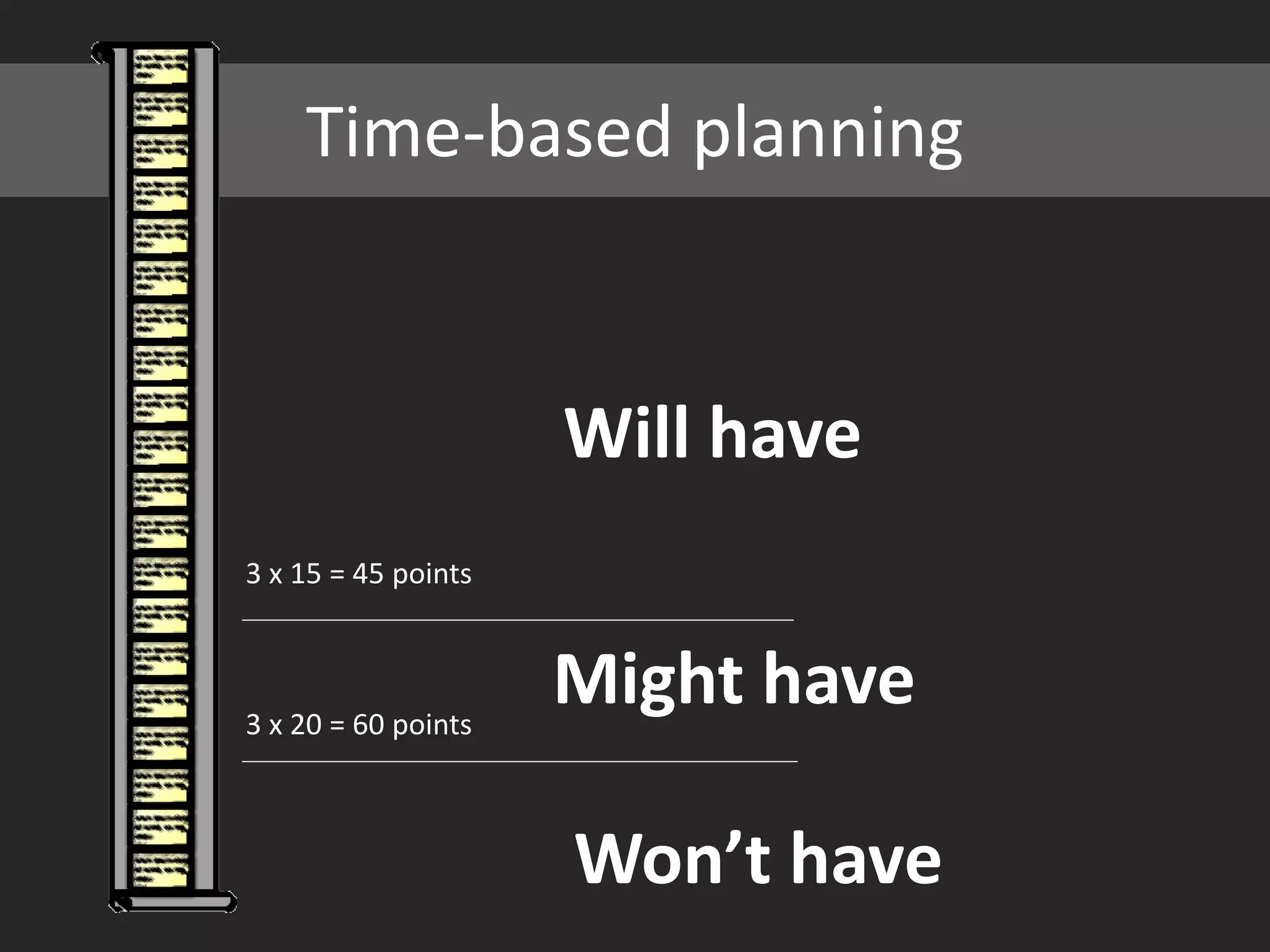

Time-based planning

                     Will have
3 x 15 = 45 points

3 x 20 = 60 points
                     Might have

                     Won’t have

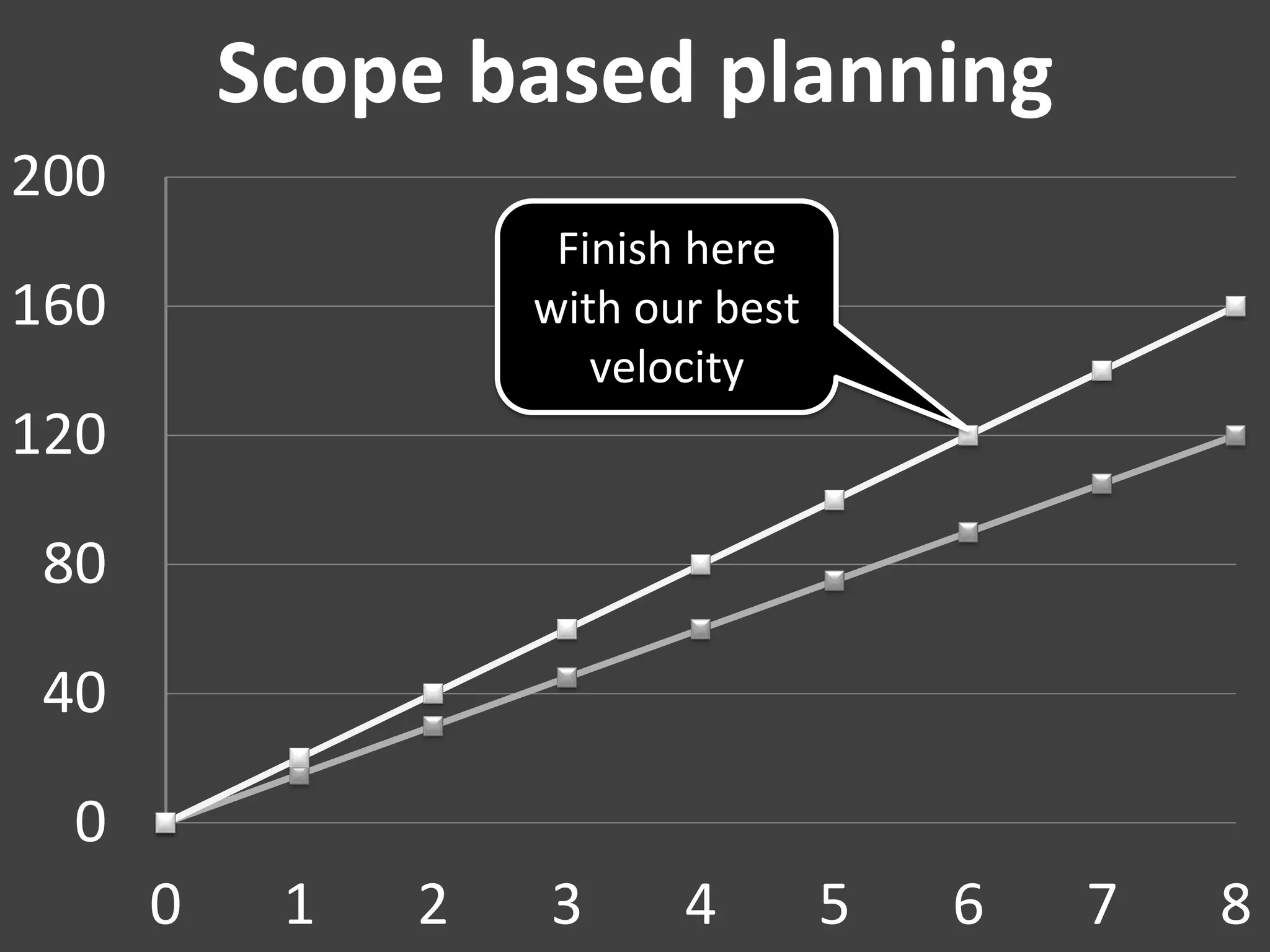

Scope based planning
200
                    Finish here
160                with our best
                      velocity
120

80

40

 0
      0    1   2   3      4        5   6   7   8
1. How many hours are in a story point?

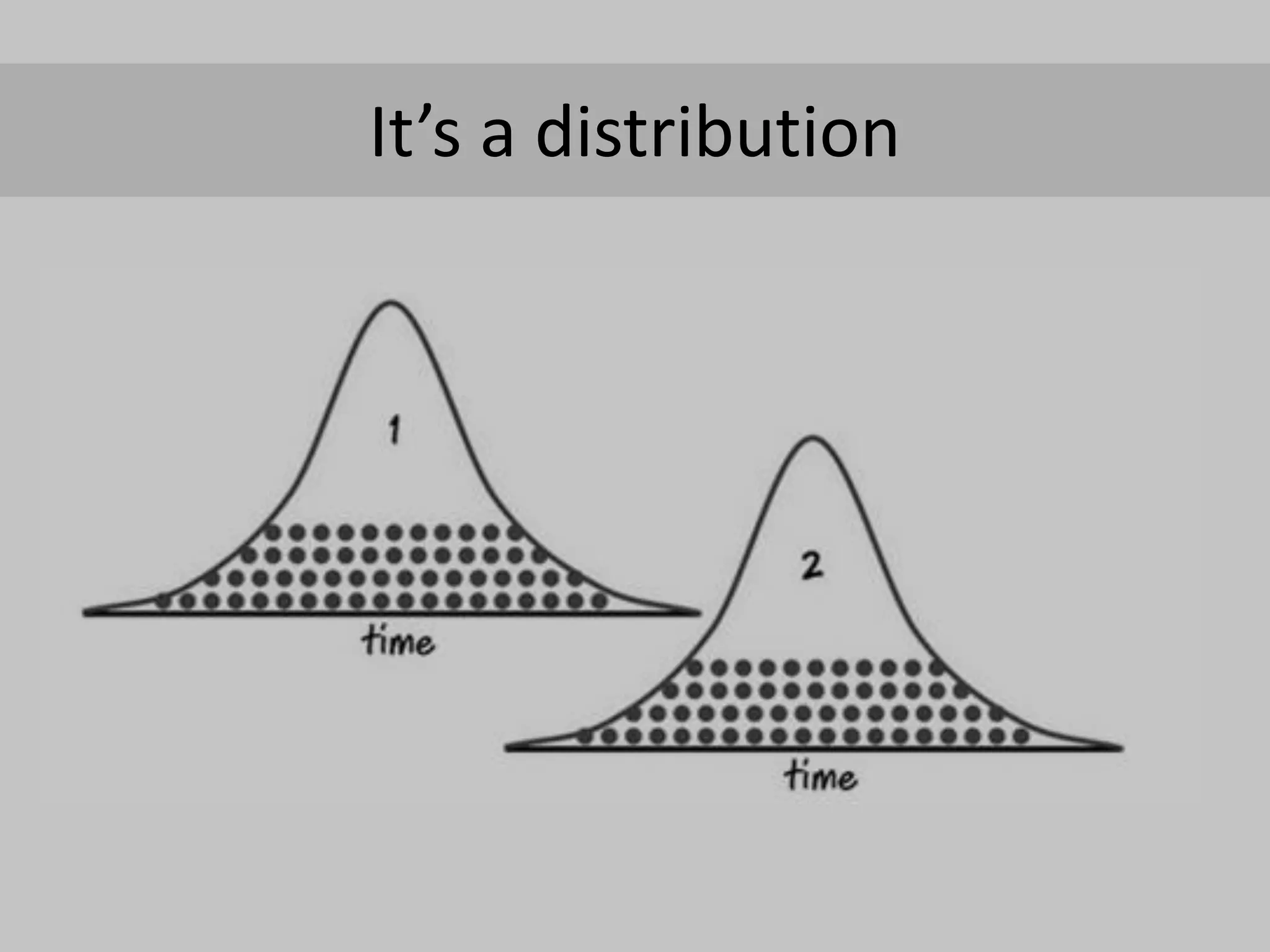

It’s a distribution
2. How to estimate cost?
6 .. 8         x        =

              ..

         It’s a range
3. Whose points are bigger
Only for the same team
Beware of inflation

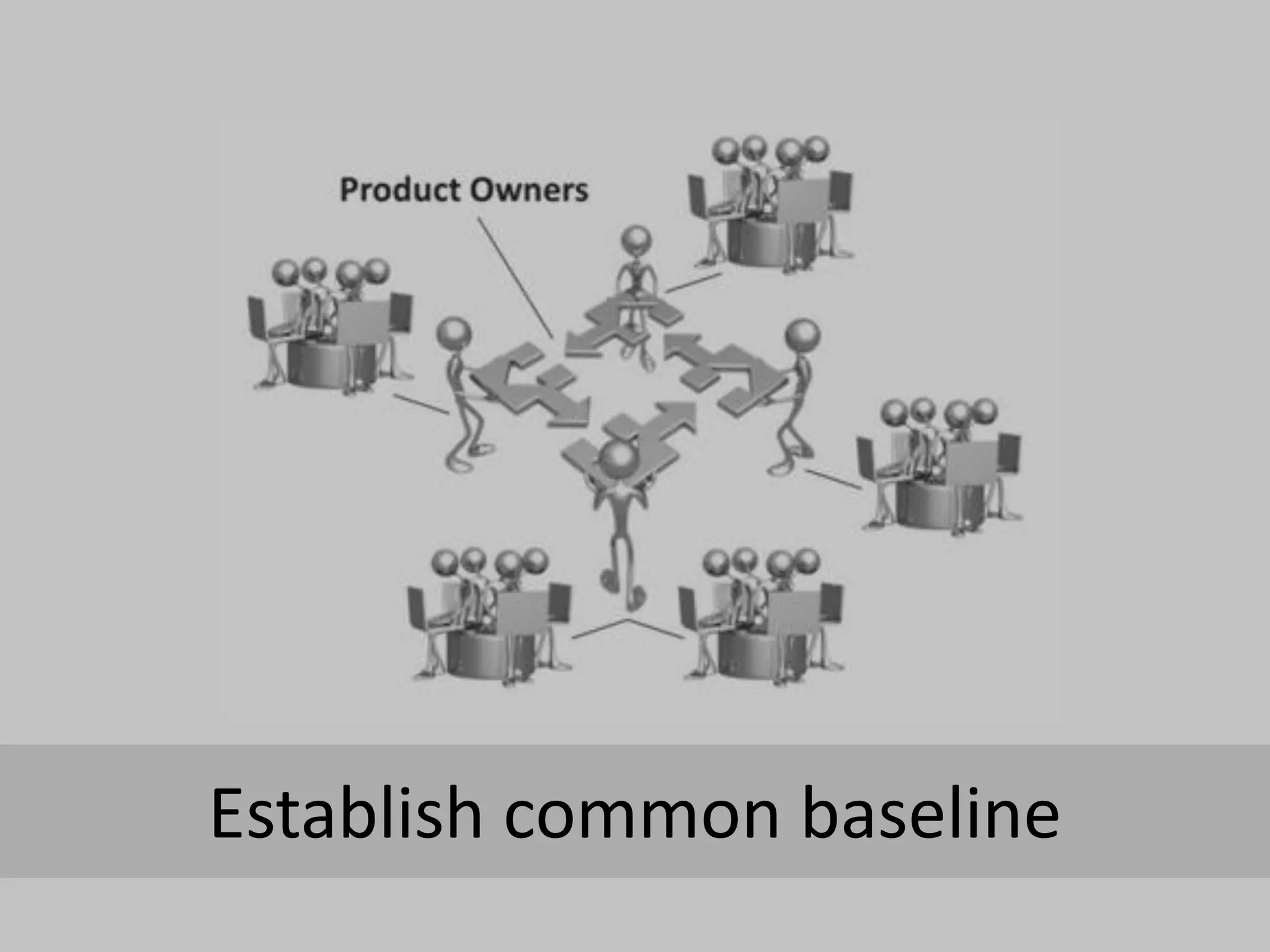

Establish common baseline
4. How to calibrate team changes

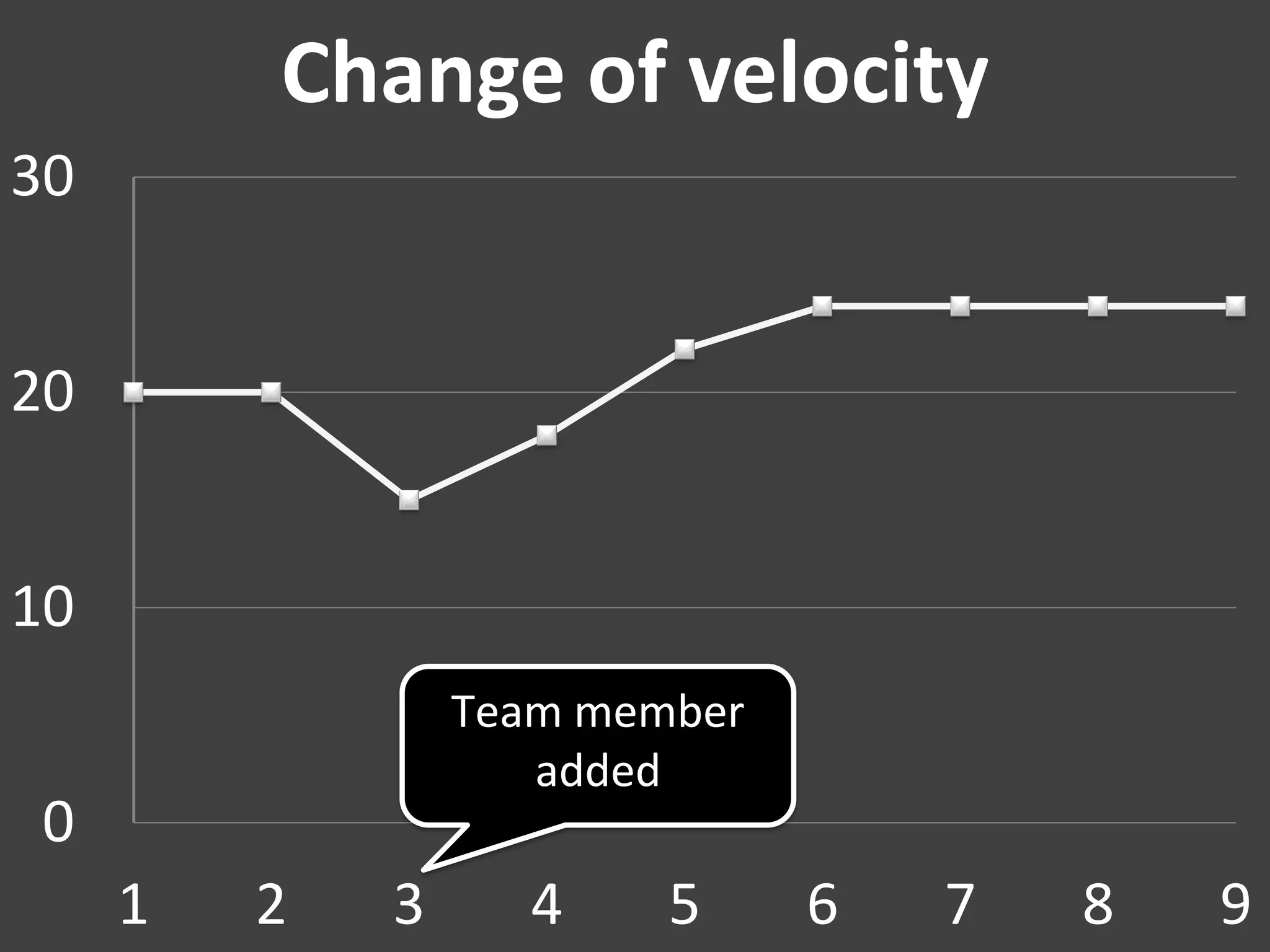

Change of velocity
30

20

10
                 Team member
                    added
0
     1   2   3     4     5     6   7   8   9
5. How to manage the inflow

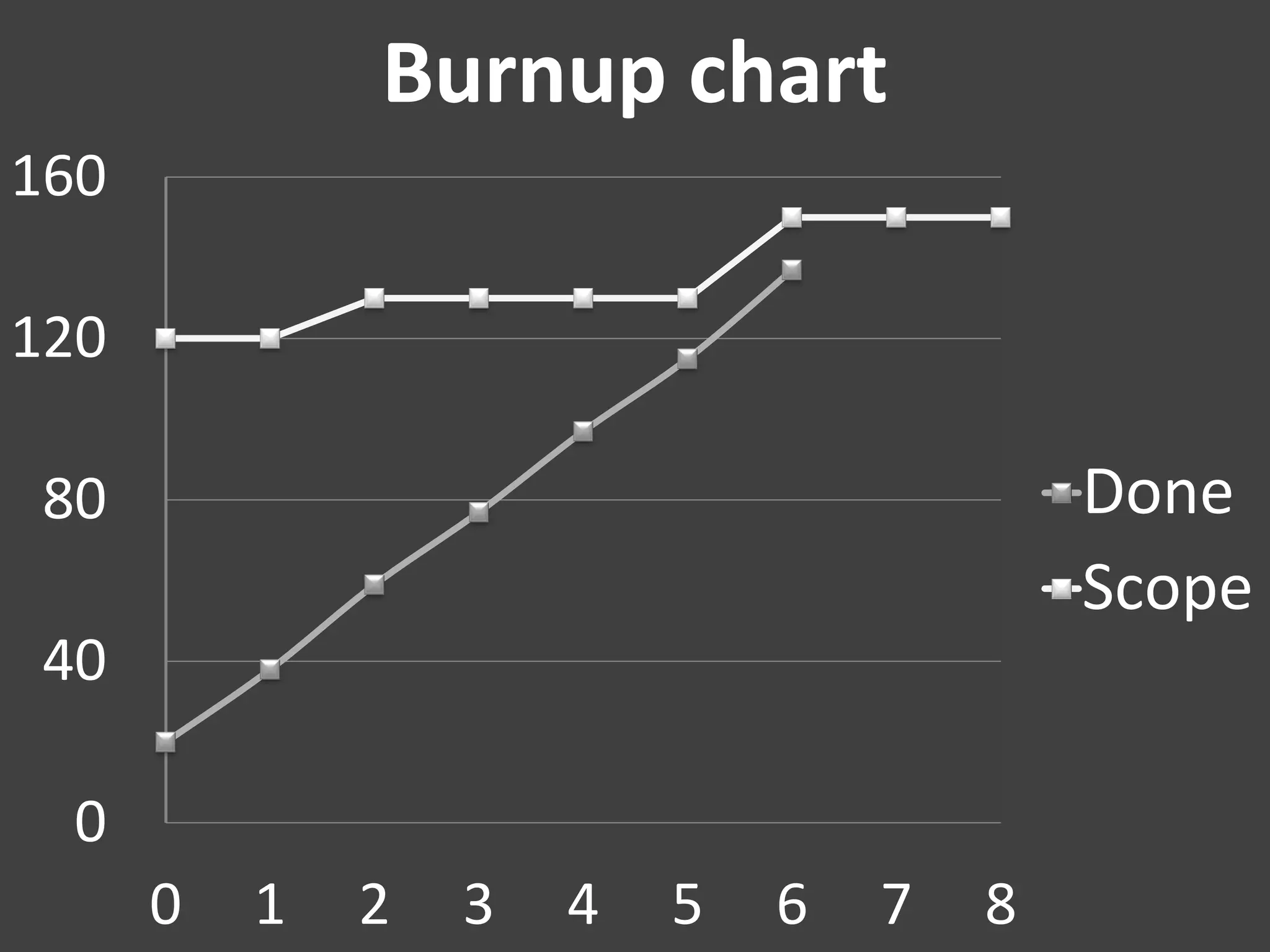

Burnup chart
160

120

80                                        Done
                                          Scope
40

 0
      0   1   2   3   4   5   6   7   8
6. How do you get started?

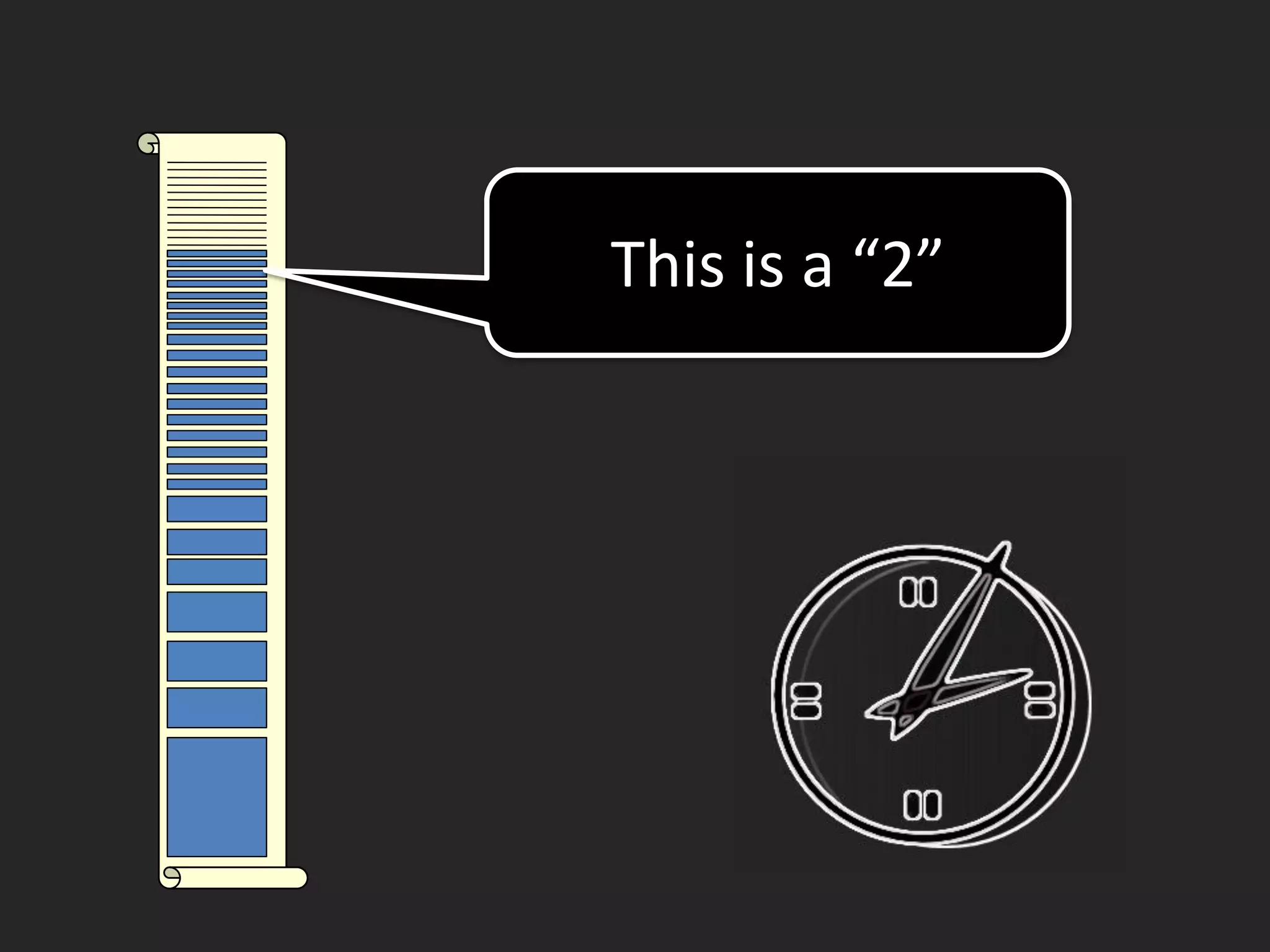

This is a “2”
7. Why are we back to hours?

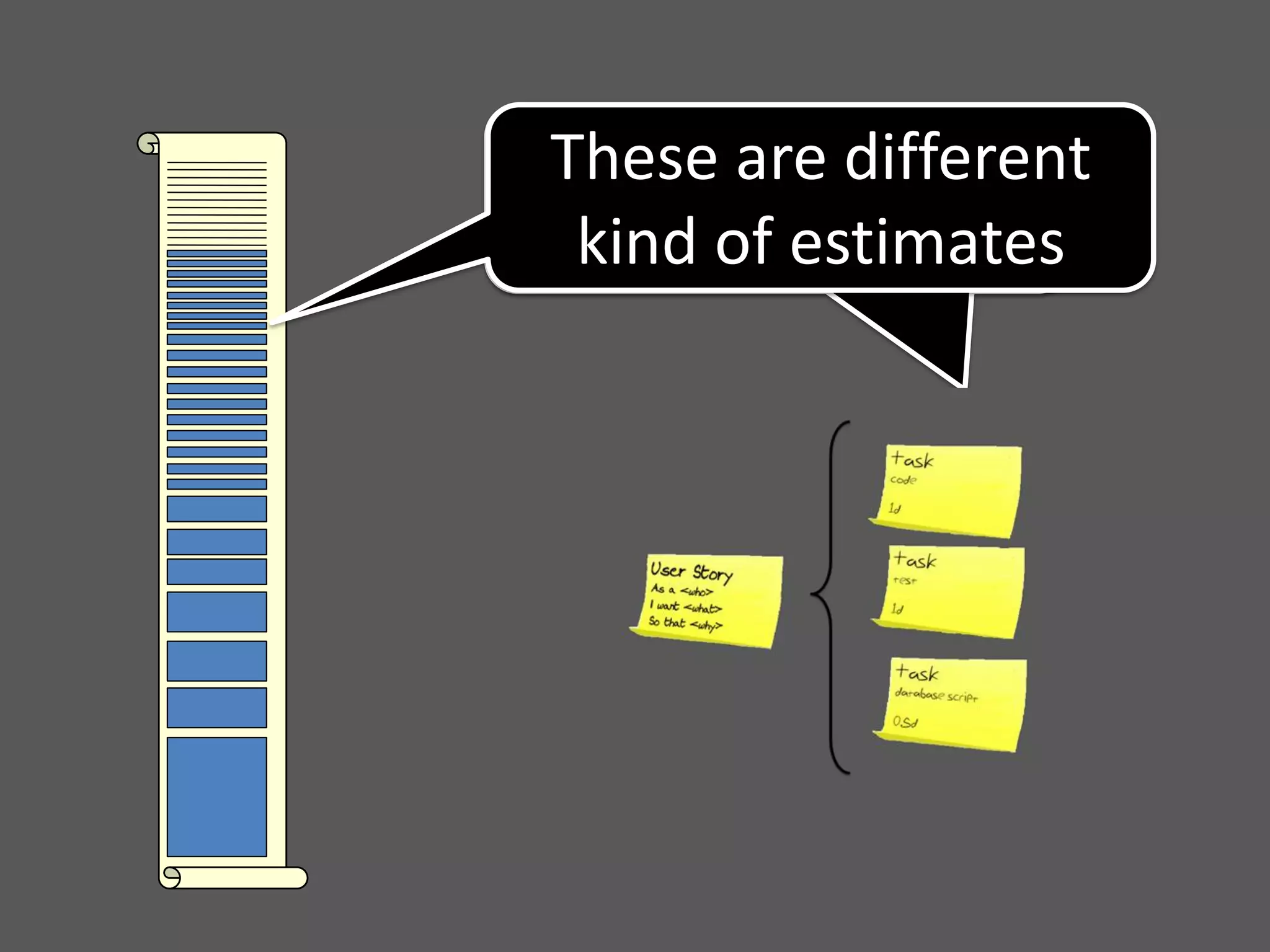

These areare
    These different
 kind of estimates
 different units

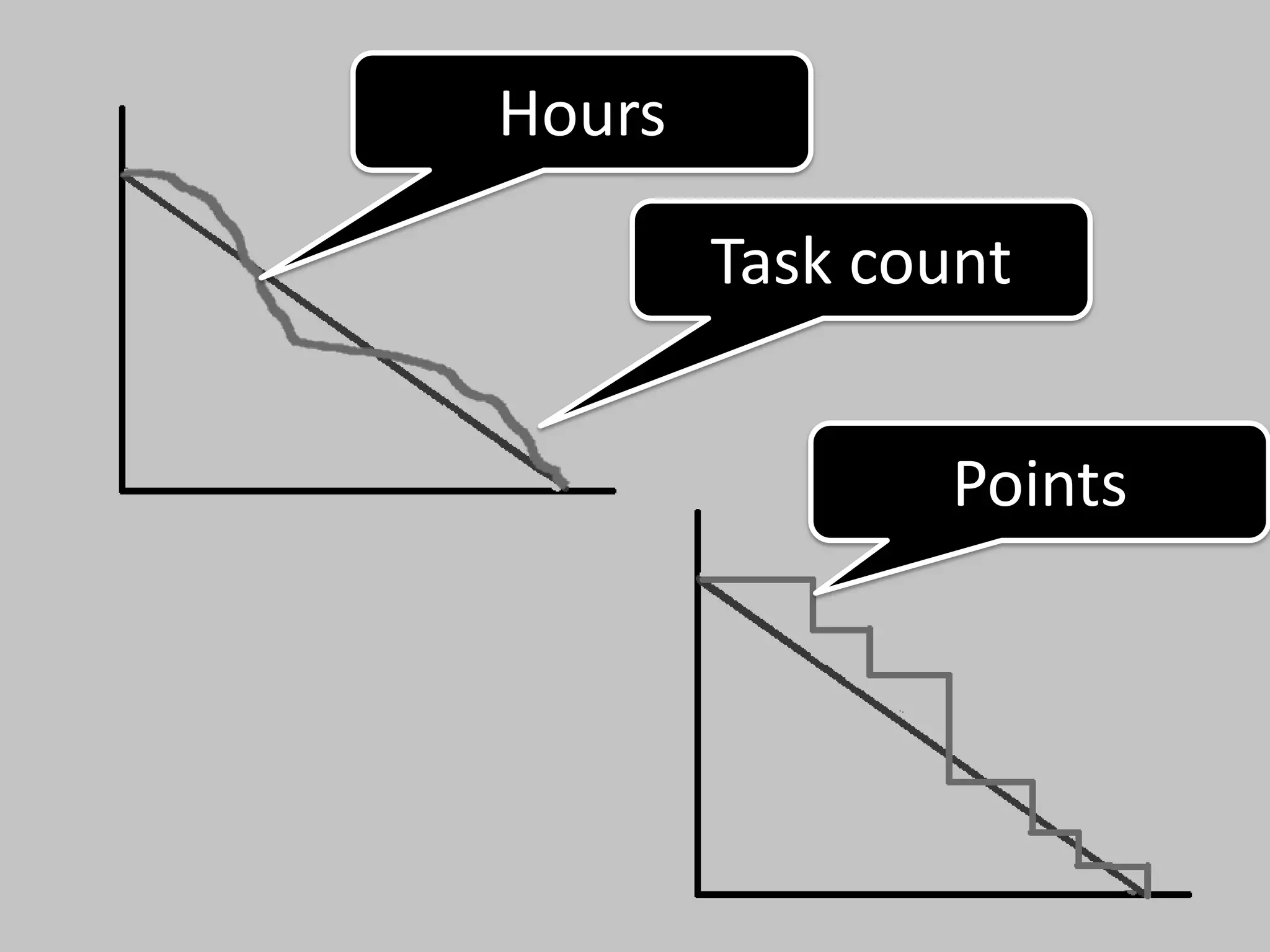

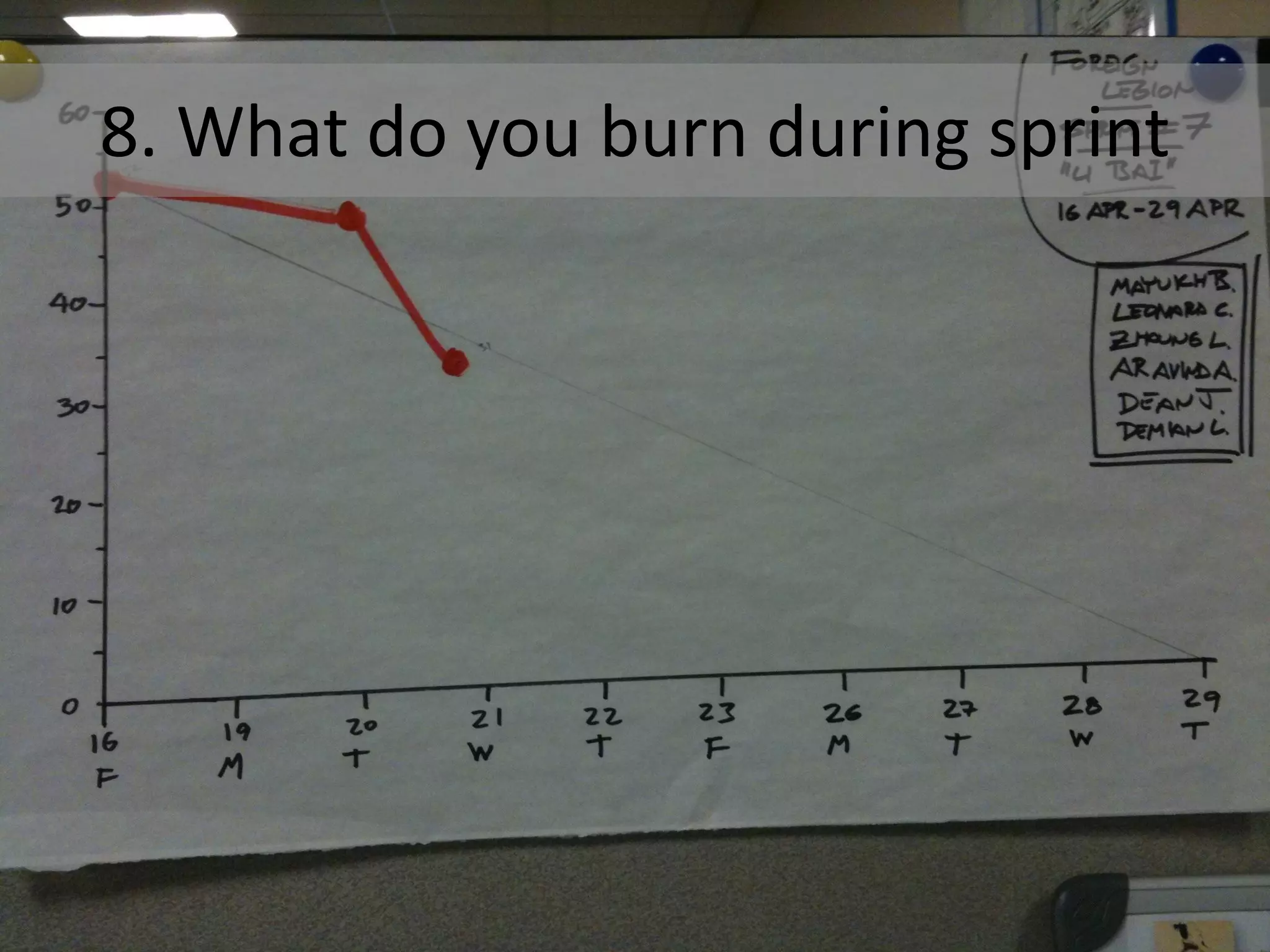

8. What do you burn during sprint
Hours

        Task count

                Points
9. What if you don’t have a team?
… plan an imaginary sprint
10. What if you have different skills?

… velocity will help

… or different teams
Estimate effort, derive duration
