Bridging the Cost/Schedule Divide:
Integrating Primavera and Cost Systems
Javier Sloninsky
EcoSys

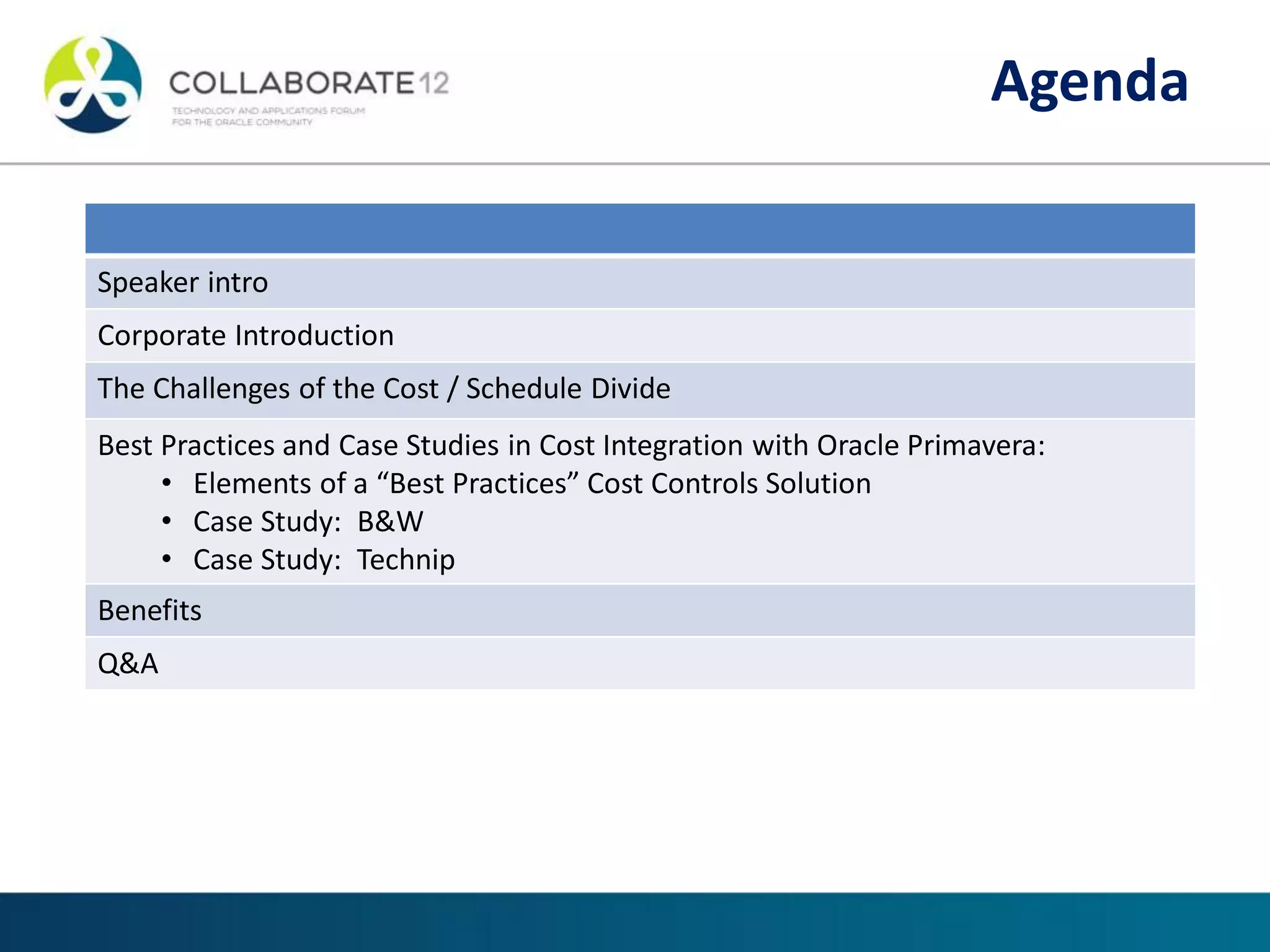

Agenda
Speaker intro
Corporate Introduction
The Challenges of the Cost / Schedule Divide
Best Practices and Case Studies in Cost Integration with Oracle Primavera:
• Elements of a “Best Practices” Cost Controls Solution
• Case Study: B&W
• Case Study: Technip
Benefits
Q&A
Founded in 2000
Enterprise Project Controls Software Experts
Designers & Developers of original Primavera P6 and EcoSys EPC
Professional Services
Enterprise Consulting Expertise: Project Portfolio & Cost Management Best Practices
Global Primavera Implementation and Systems Integration Leader
Partnerships with Oracle, SAP, Accenture, Microsoft, IBM
250 Customers in Global 1000 and Public Sector
EcoSys Company Background
• Project Controls System Designers
• Project Controls Implementers:
– Owners and Operators
– Contractors
– Public sector
• Enterprise architecture mindset
• Partnership approach with industry
• Constant evolution
Our Perspective
Our Perspective
Representative Customers
6
EcoSys EPC Certified to run seamlessly
with Oracle and SAP:
Professional Partnerships with Global Tech Leaders:
Global Technology Partners
The Cost/Schedule Divide
Cost Schedule
• Control
• Structure
• Auditable
• Dynamic
• Flexible
?

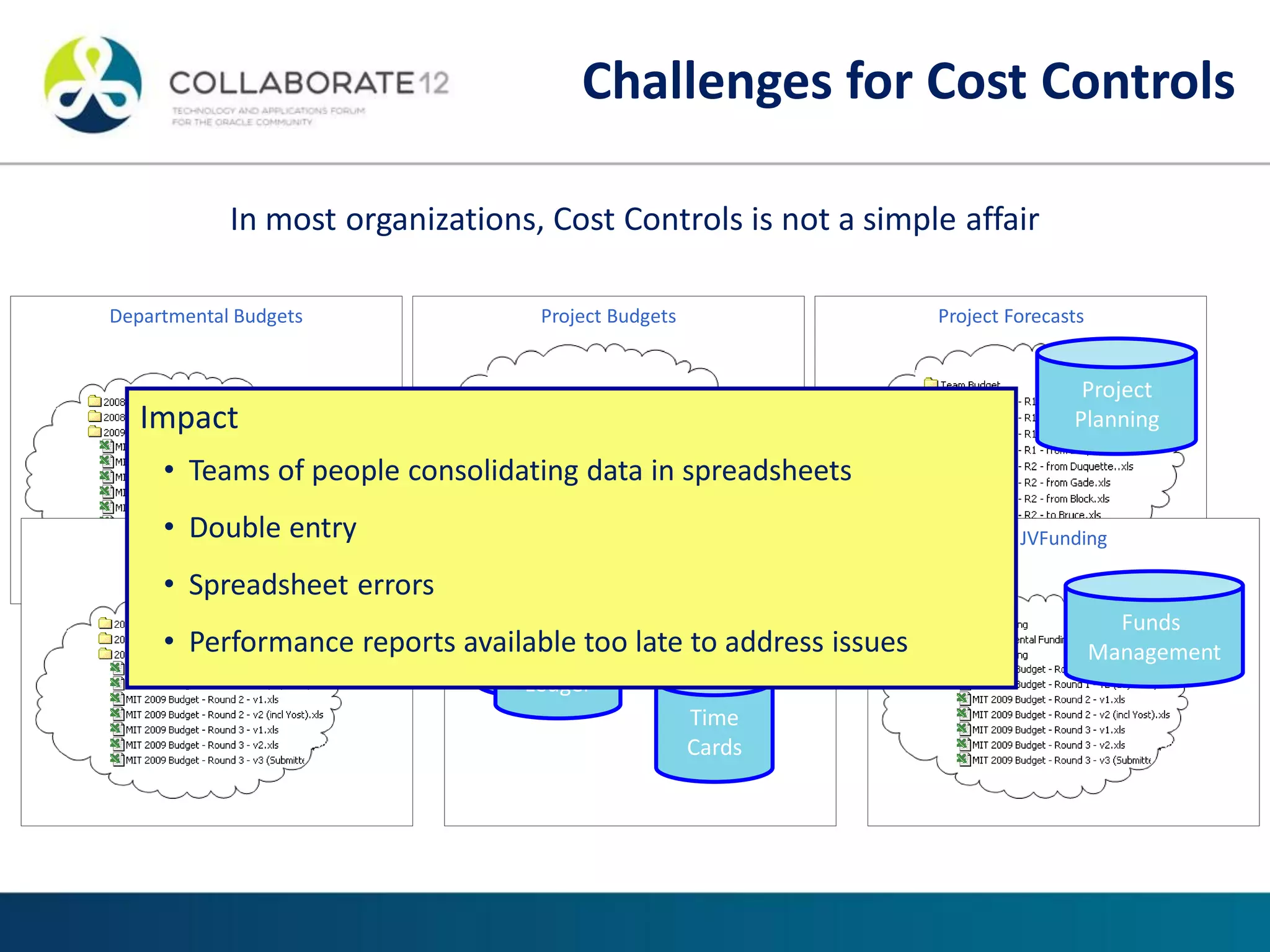

In most organizations, Cost Controls is not a simple affair
Departmental Budgets Project ForecastsProject Budgets
Actual TransactionsCommitments
Contract
Database
Project
Planning
General
LedgerGeneral
Ledger
Time
Cards
JVFunding
Funds
Management
Impact
• Teams of people consolidating data in spreadsheets
• Double entry
• Spreadsheet errors
• Performance reports available too late to address issues
Challenges for Cost Controls

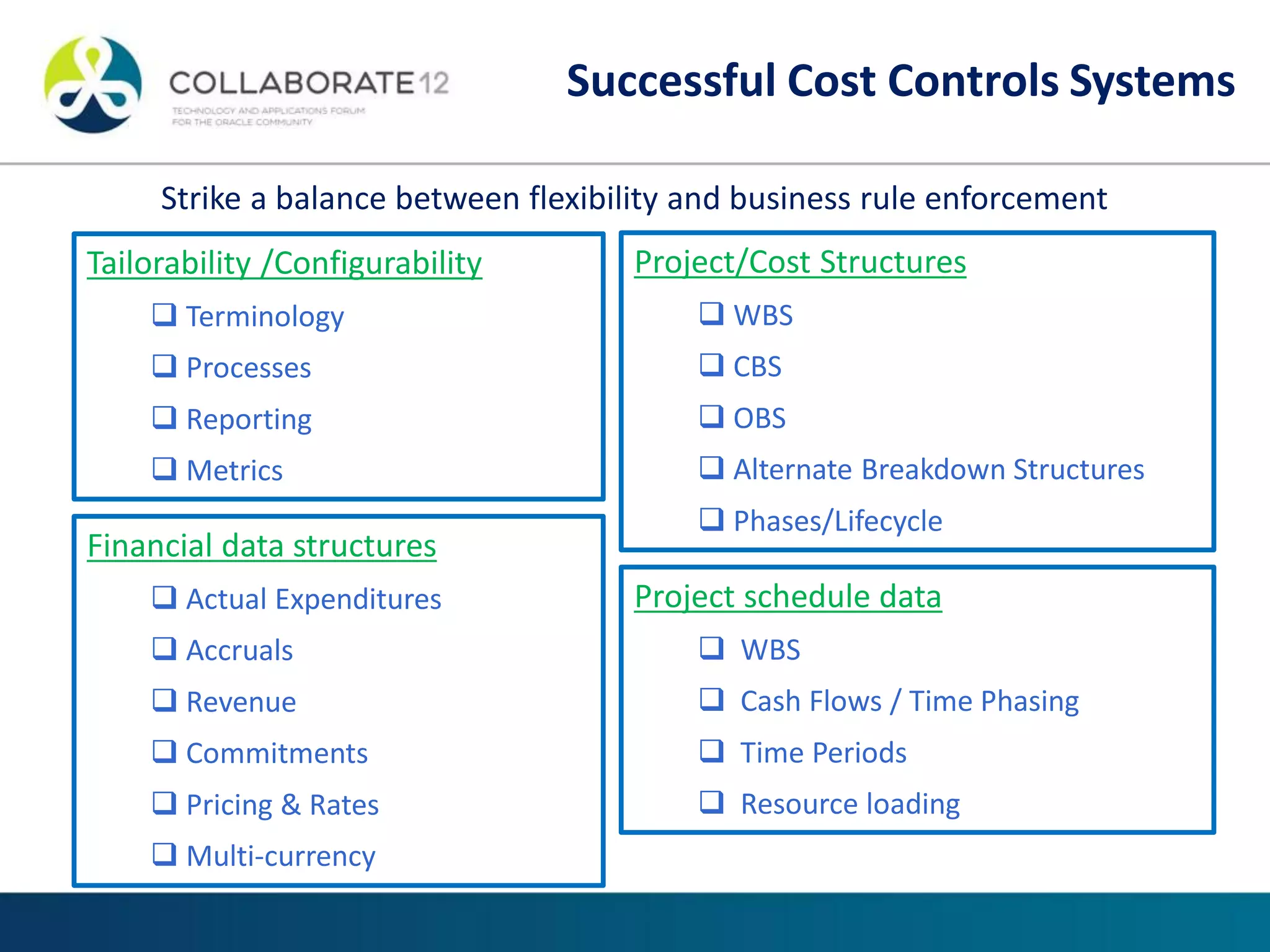

Strike a balance between flexibility and business rule enforcement
Tailorability /Configurability
 Terminology
 Processes
 Reporting
 Metrics
Project/Cost Structures
 WBS
 CBS
 OBS
 Alternate Breakdown Structures
 Phases/Lifecycle
Financial data structures
 Actual Expenditures
 Accruals
 Revenue
 Commitments
 Pricing & Rates
 Multi-currency
Project schedule data
 WBS
 Cash Flows / Time Phasing
 Time Periods
 Resource loading
Successful Cost Controls Systems

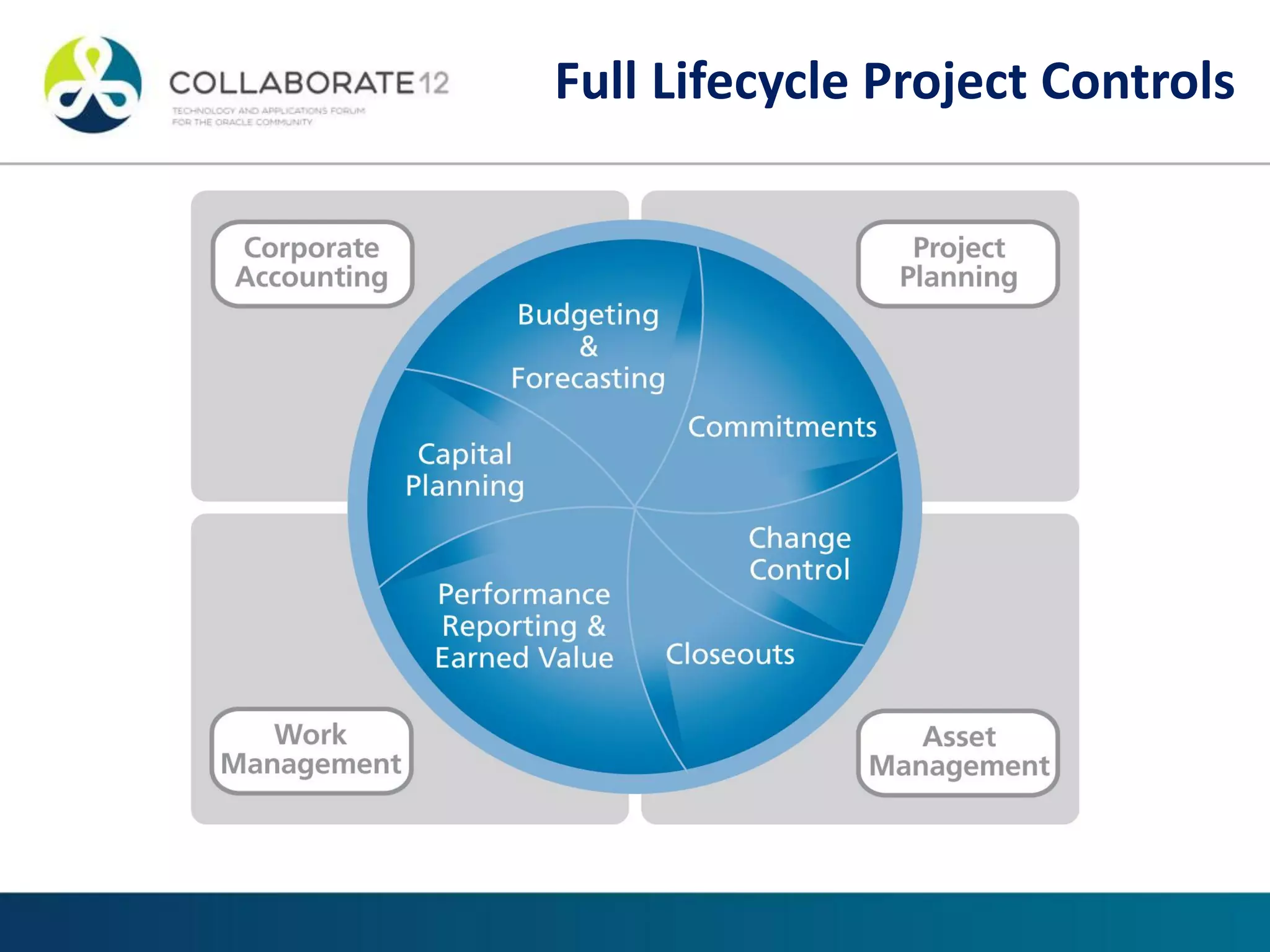

Full Lifecycle Project Controls

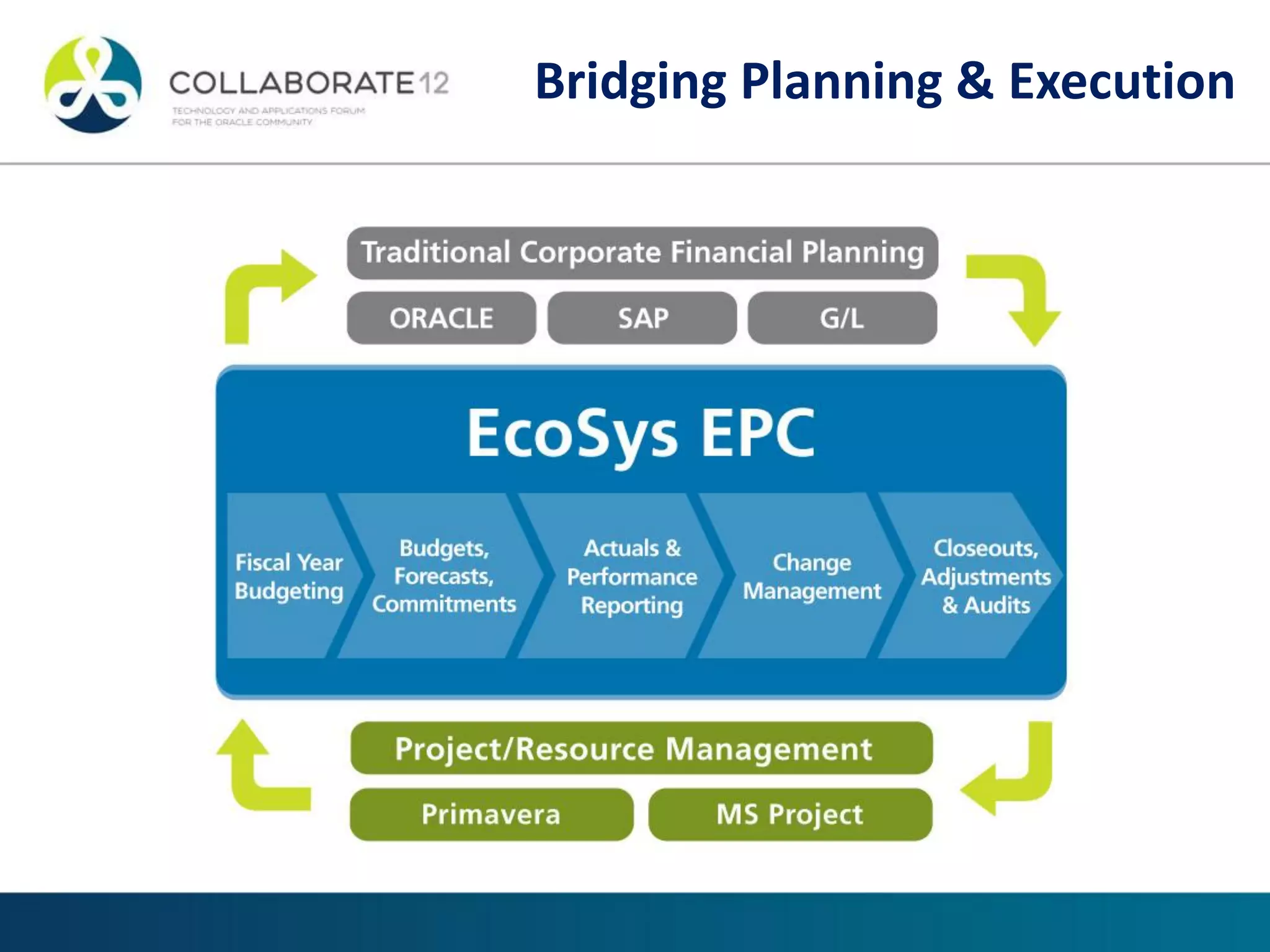

Bridging Planning & Execution

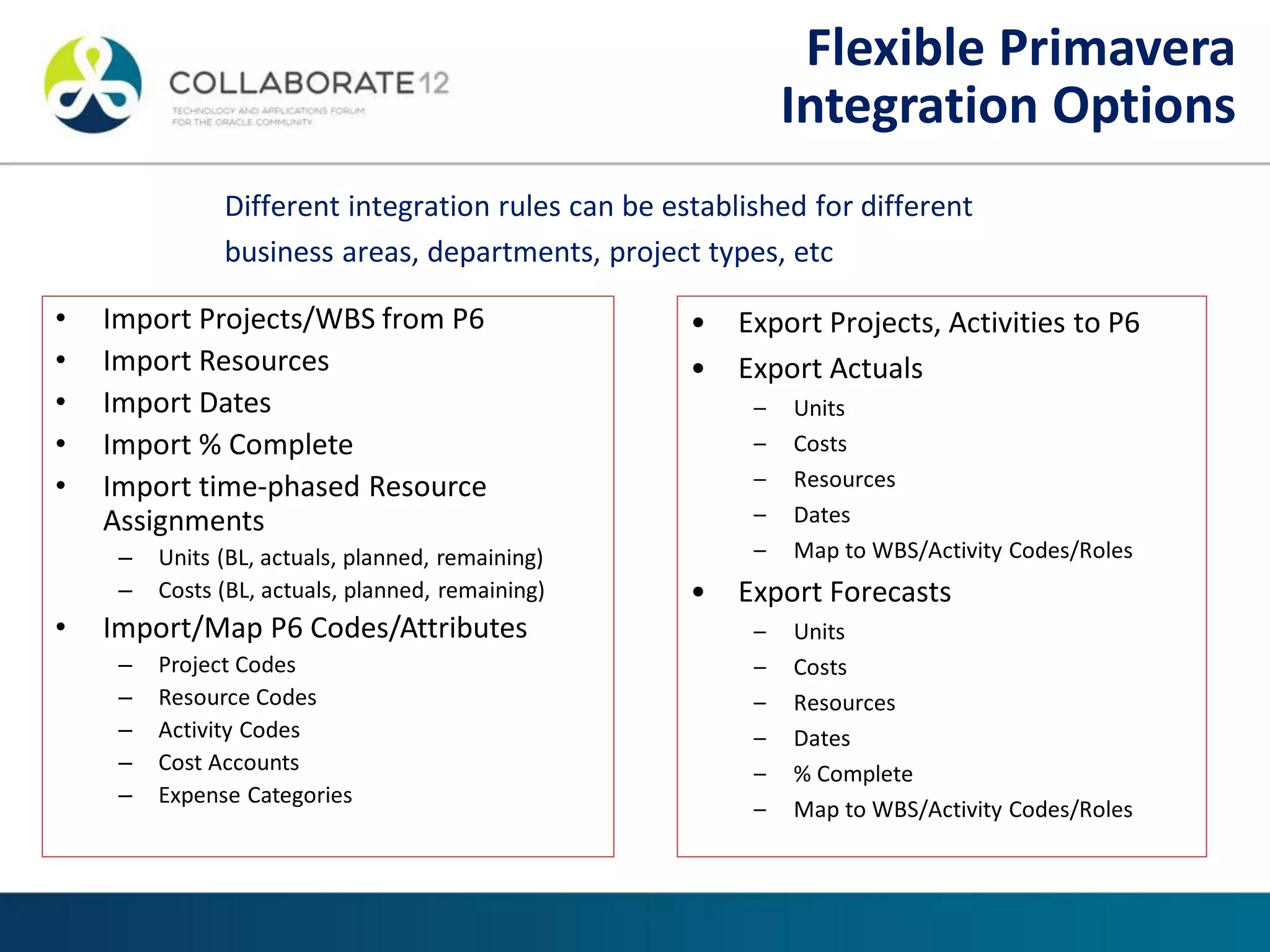

• Import Projects/WBS from P6
• Import Resources
• Import Dates
• Import % Complete
• Import time-phased Resource
Assignments
– Units (BL, actuals, planned, remaining)
– Costs (BL, actuals, planned, remaining)
• Import/Map P6 Codes/Attributes
– Project Codes
– Resource Codes
– Activity Codes
– Cost Accounts
– Expense Categories
Different integration rules can be established for different
business areas, departments, project types, etc
• Export Projects, Activities to P6
• Export Actuals
– Units
– Costs
– Resources
– Dates
– Map to WBS/Activity Codes/Roles
• Export Forecasts
– Units
– Costs
– Resources
– Dates
– % Complete
– Map to WBS/Activity Codes/Roles
Flexible Primavera
Integration Options
Create Projects and
Build WBS in EcoSys, or
import from Primavera,
or other systems.
Budget in EcoSys, or
Import from Primavera,
Oracle Projects, etc.
Actuals from General
Ledger and/or from
Accruals
Import Commitments or
Manage in EcoSys
Progress and Forecast in
EcoSys, and compare to
cost loaded schedules,
contractor forecasts
Maintain Each Version in
EcoSys, gaining Trending
and Audit Trail

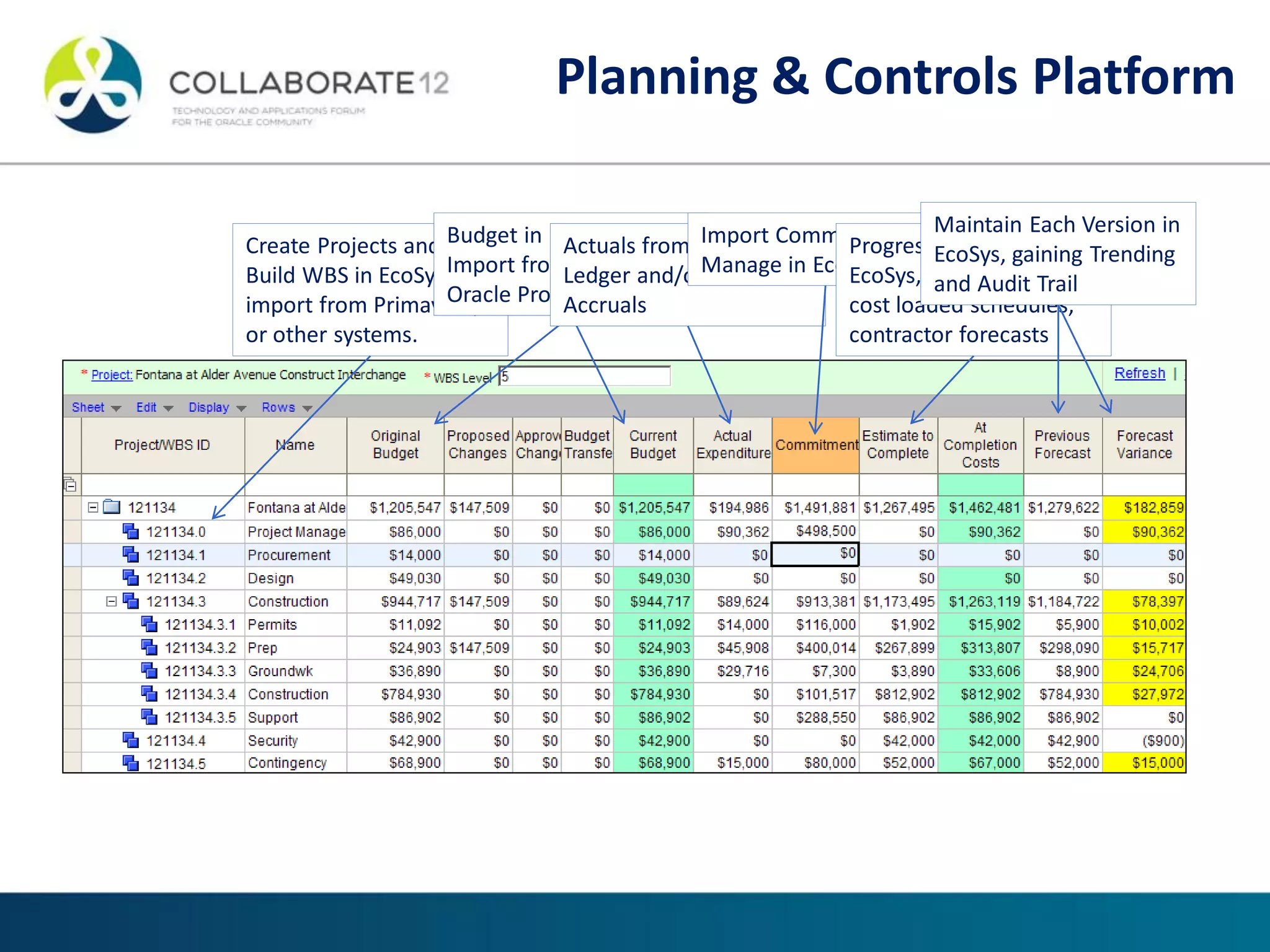

Planning & Controls Platform

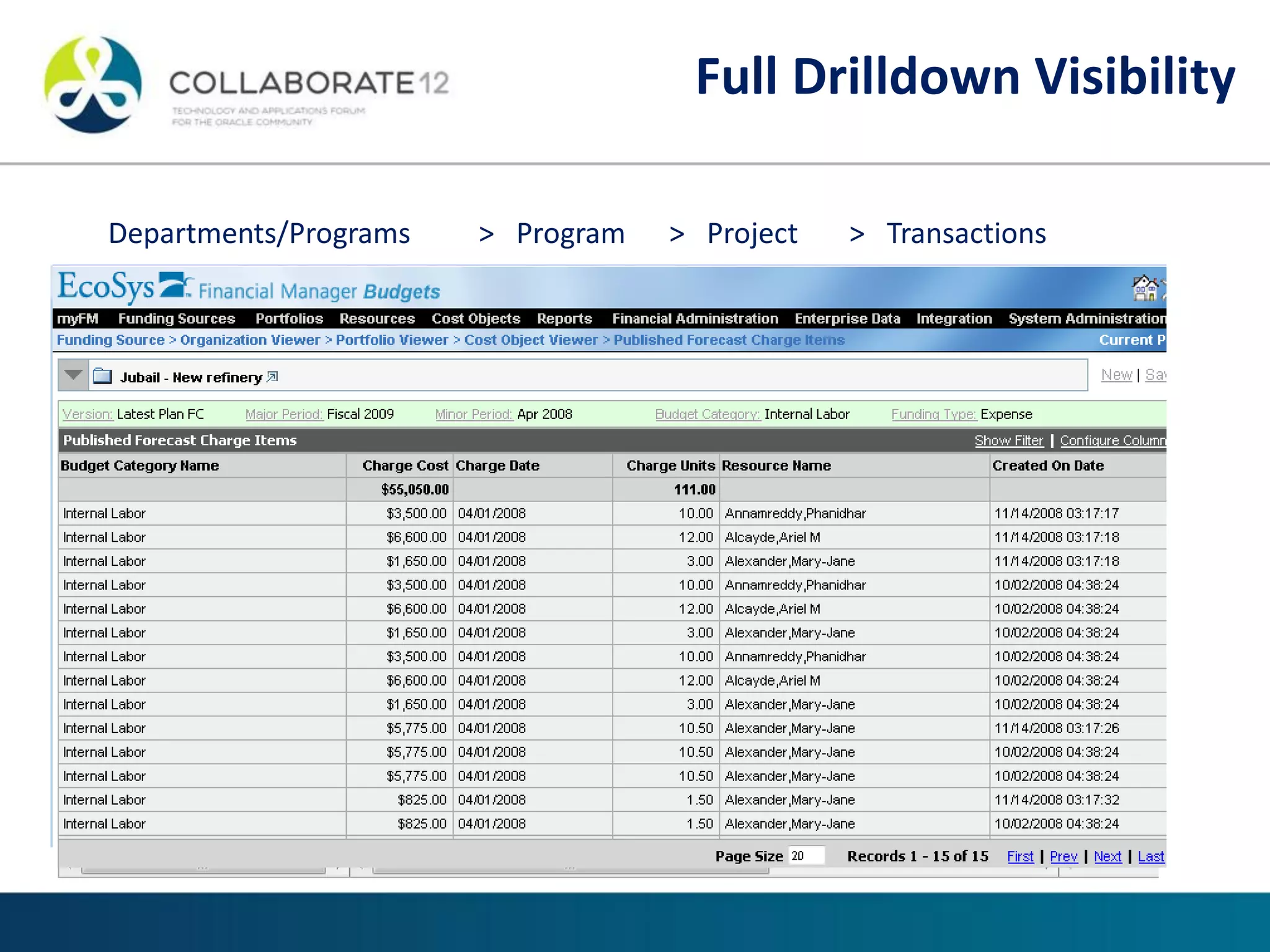

Departments/Programs > Program > Project > Transactions
Full Drilldown Visibility

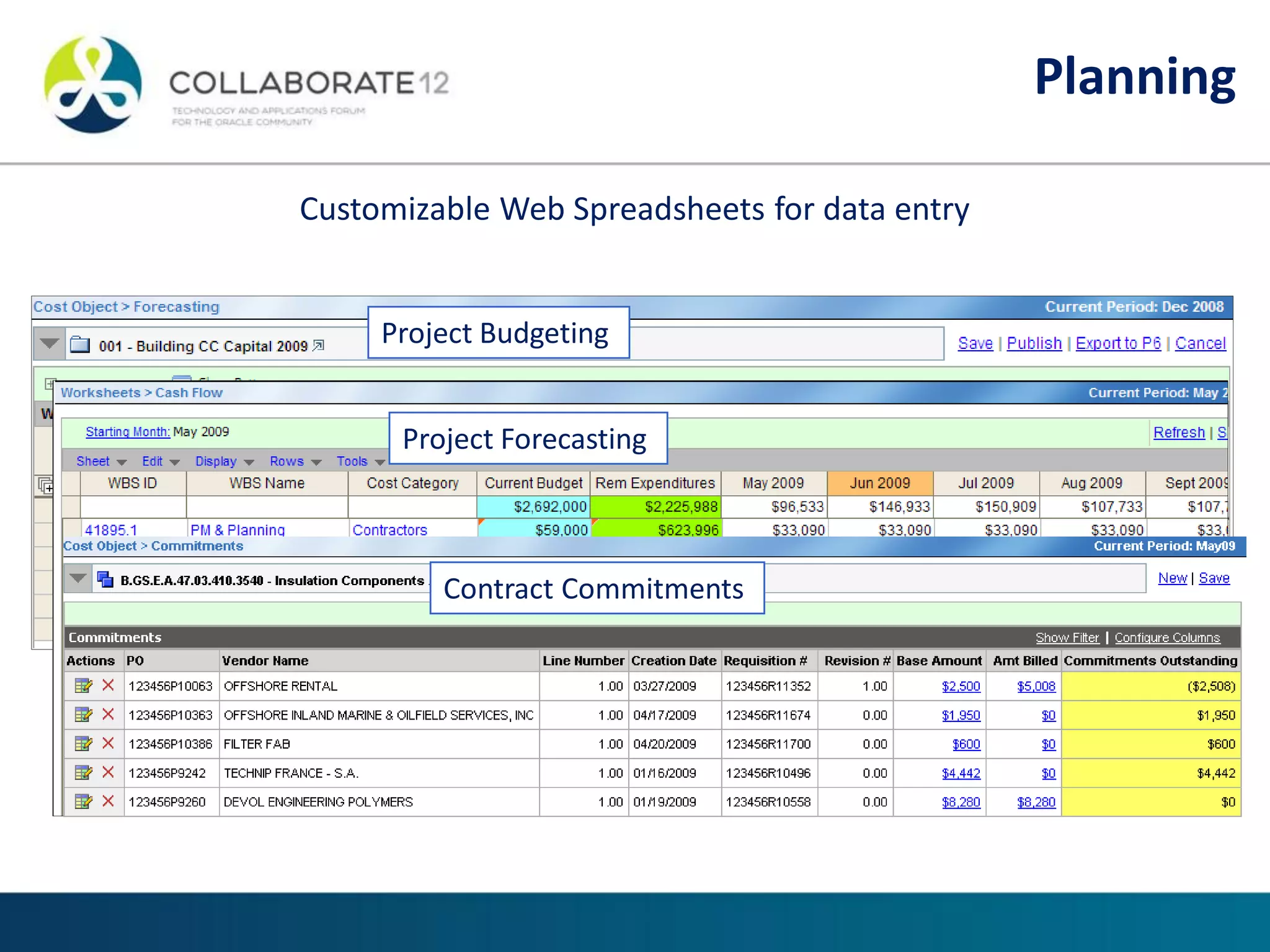

Project Budgeting
Project Forecasting
Contract Commitments
Planning
Customizable Web Spreadsheets for data entry

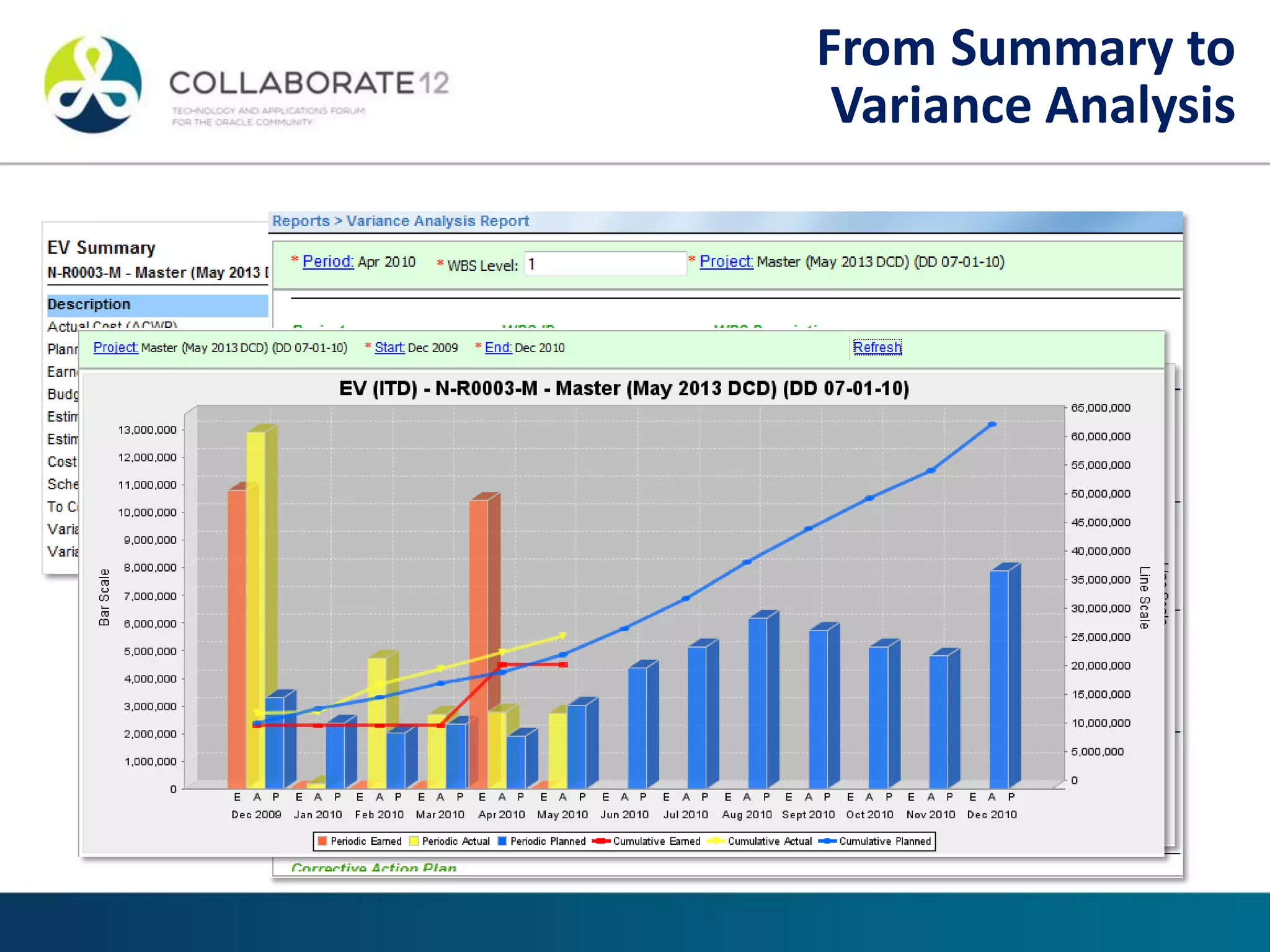

From Summary to
Variance Analysis

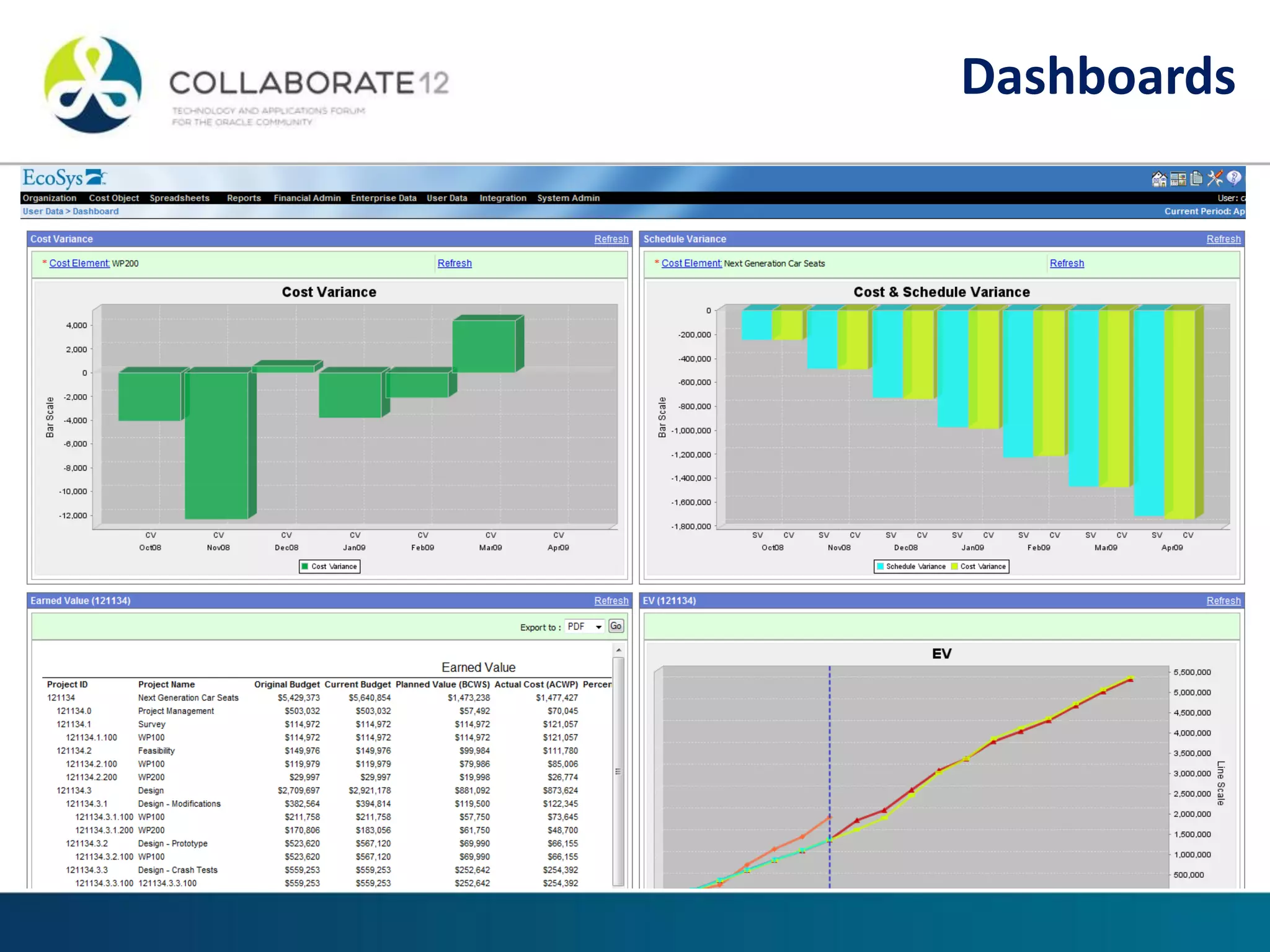

Dashboards

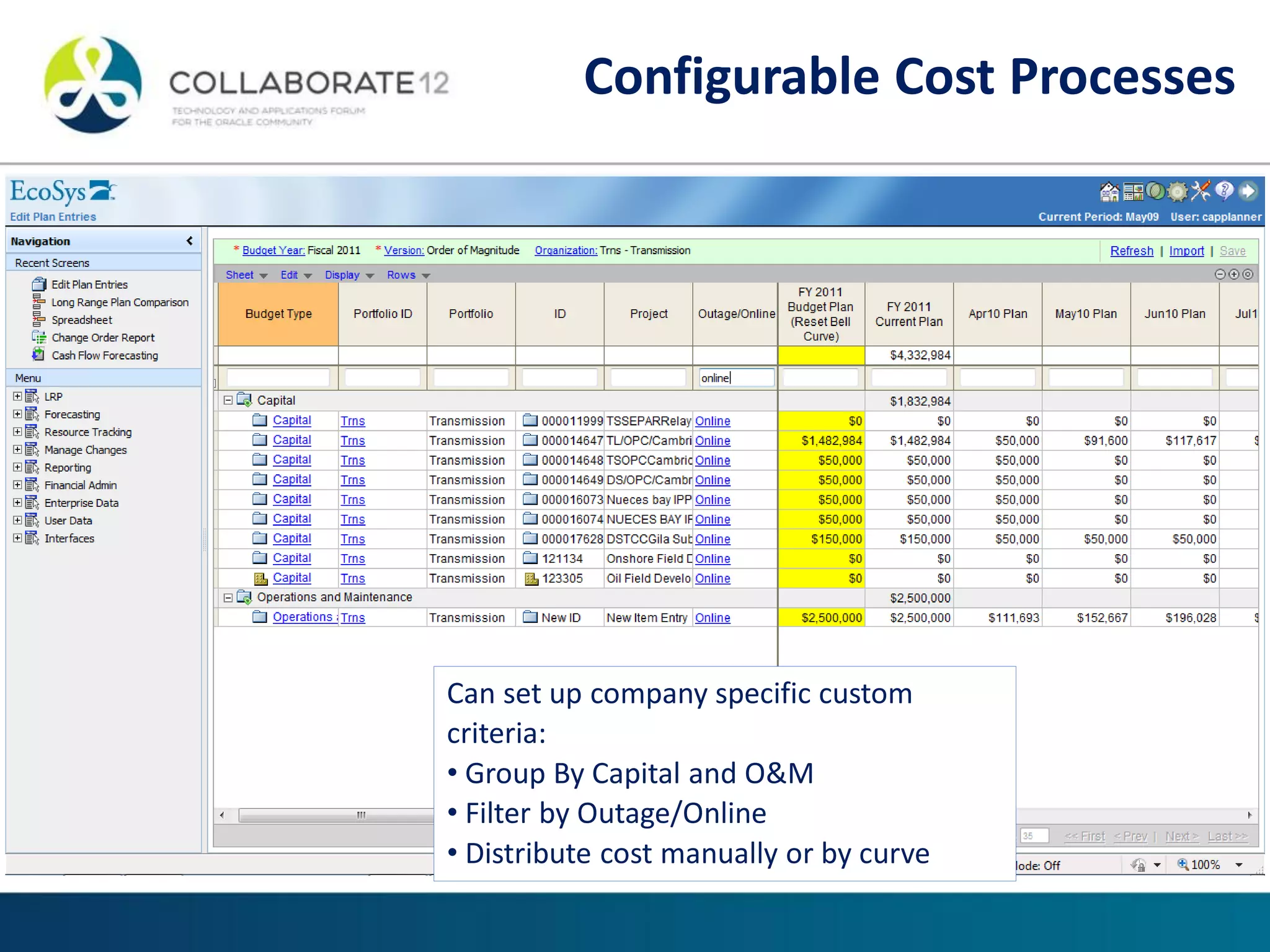

Can set up company specific custom
criteria:
• Group By Capital and O&M
• Filter by Outage/Online
• Distribute cost manually or by curve
Configurable Cost Processes

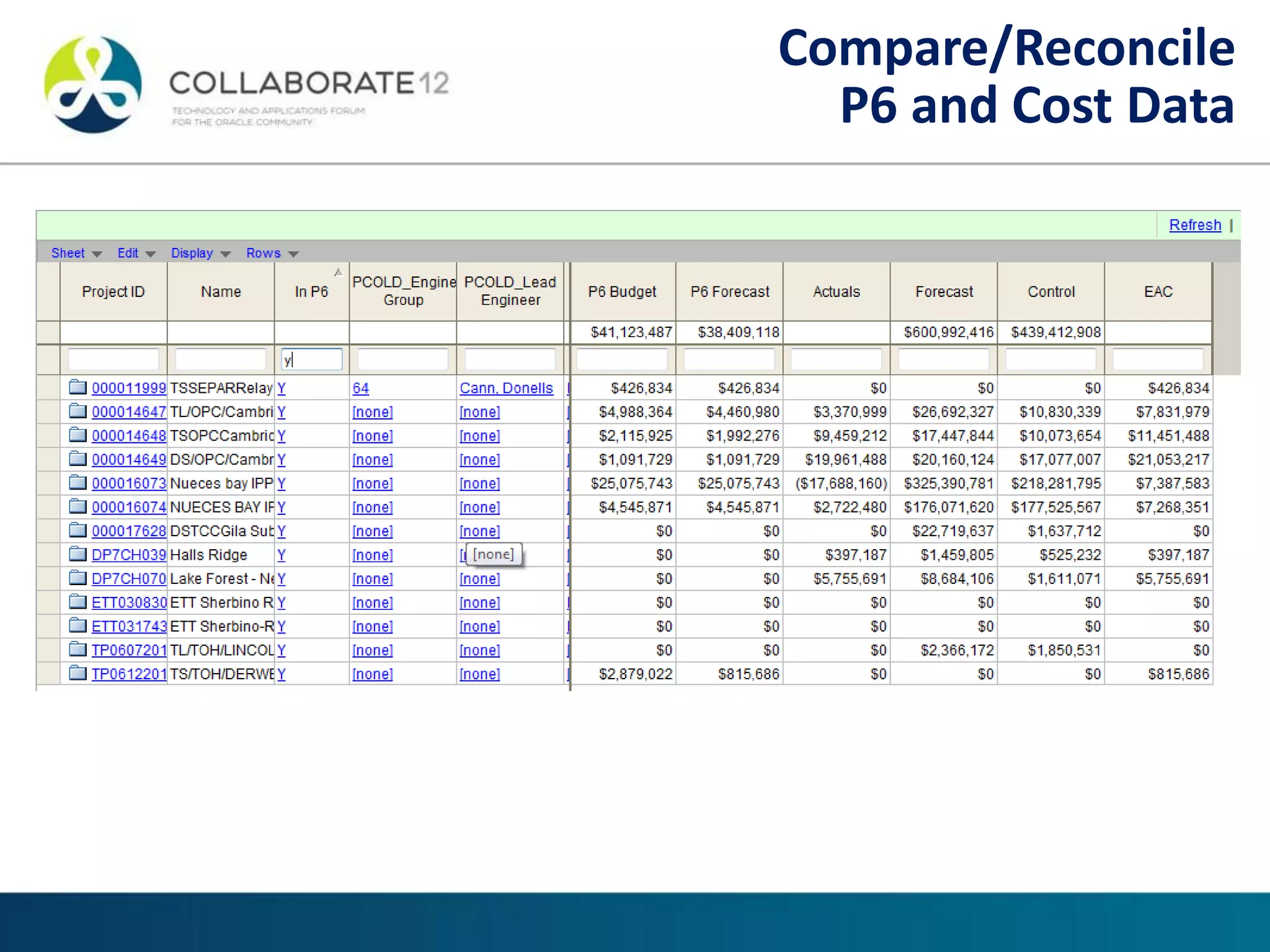

Compare/Reconcile
P6 and Cost Data

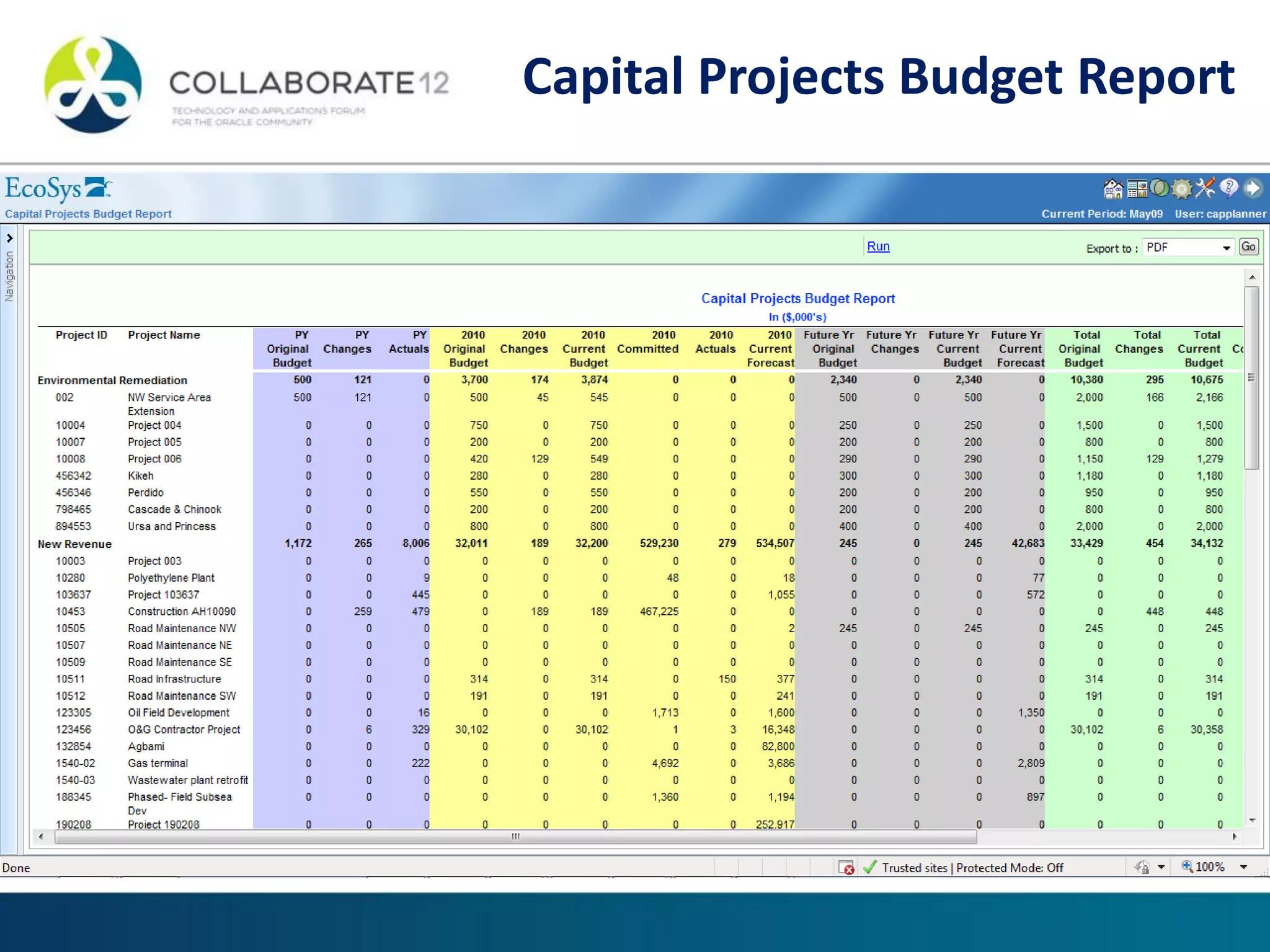

Capital Projects Budget Report

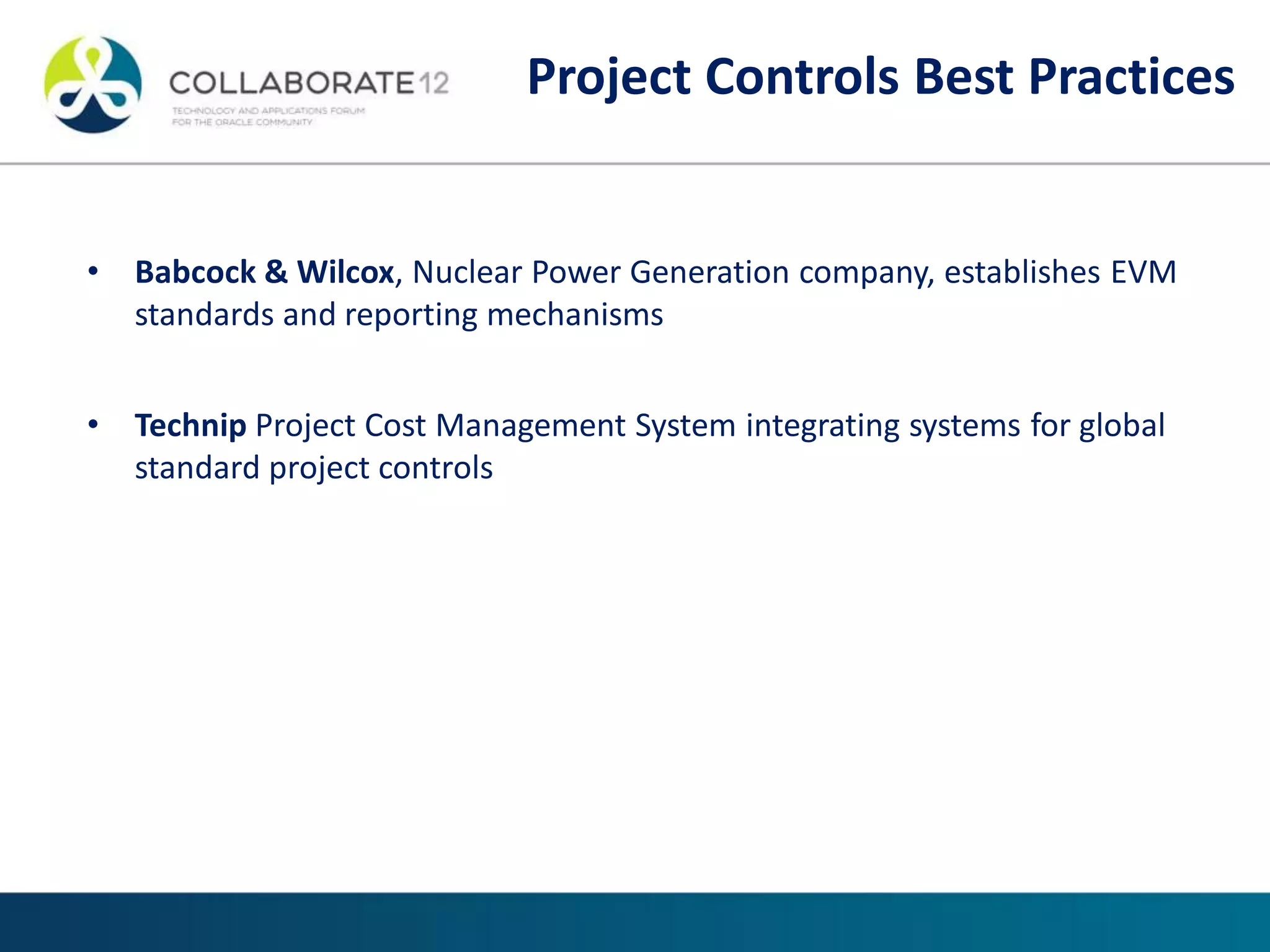

• Babcock & Wilcox, Nuclear Power Generation company, establishes EVM
standards and reporting mechanisms
• Technip Project Cost Management System integrating systems for global
standard project controls

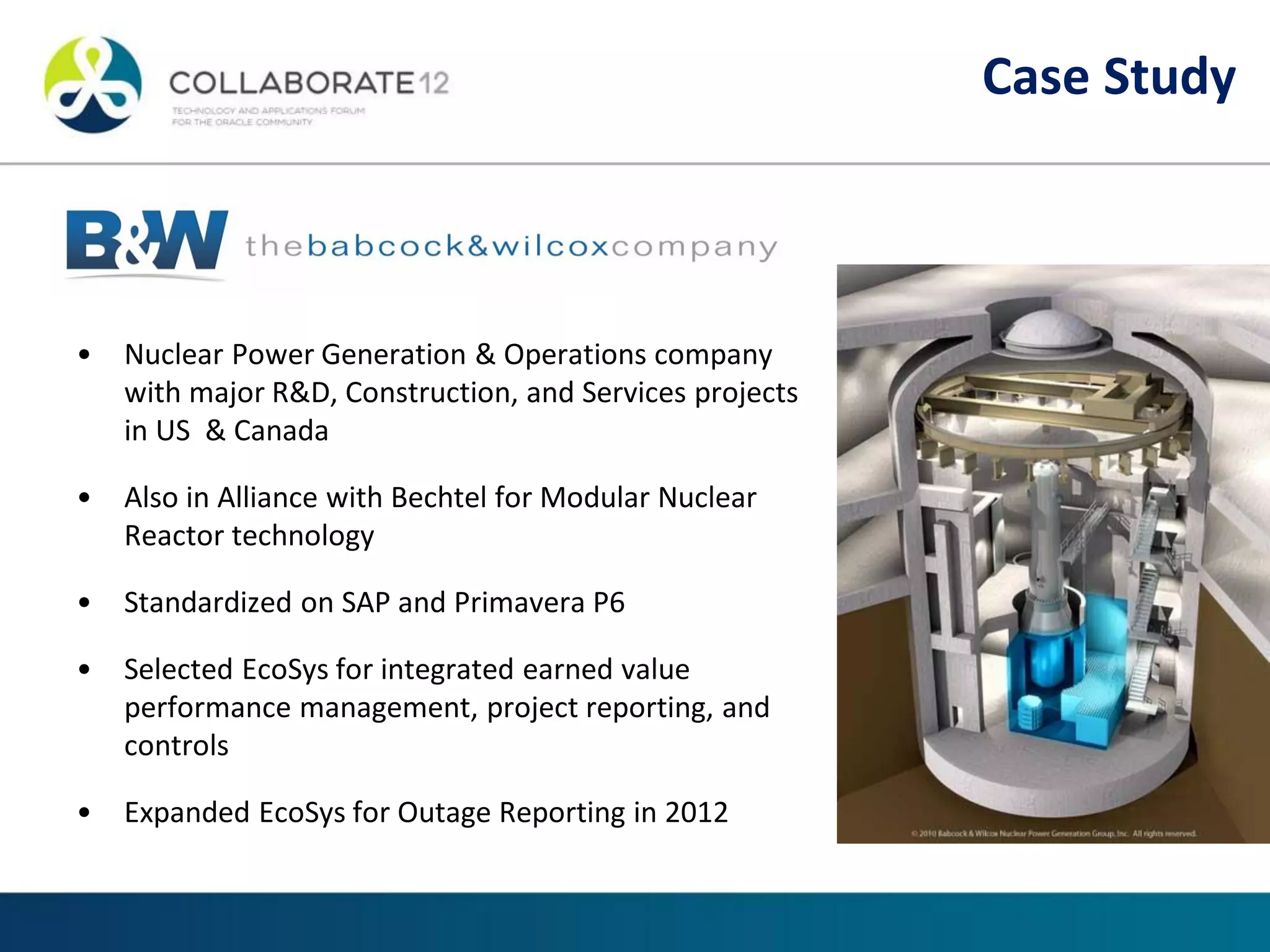

Project Controls Best Practices
• Nuclear Power Generation & Operations company
with major R&D, Construction, and Services projects
in US & Canada
• Also in Alliance with Bechtel for Modular Nuclear
Reactor technology
• Standardized on SAP and Primavera P6
• Selected EcoSys for integrated earned value
performance management, project reporting, and
controls
• Expanded EcoSys for Outage Reporting in 2012
Case Study

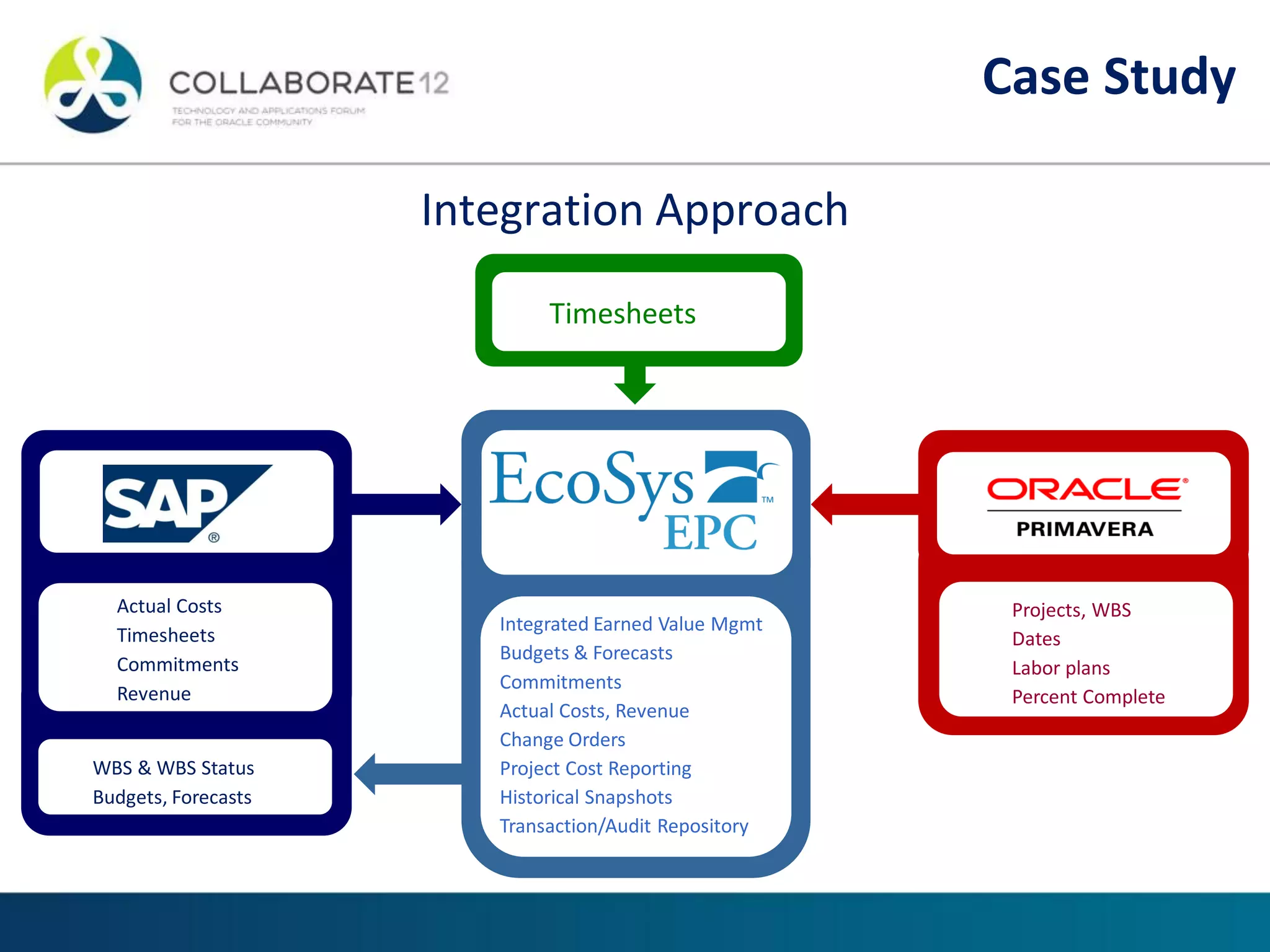

WBS & WBS Status
Budgets, Forecasts
Integrated Earned Value Mgmt
Budgets & Forecasts
Commitments
Actual Costs, Revenue
Change Orders
Project Cost Reporting
Historical Snapshots
Transaction/Audit Repository
Projects, WBS
Dates
Labor plans
Percent Complete
Actual Costs
Timesheets
Commitments
Revenue
Case Study
Timesheets
Case Study
Integration Approach

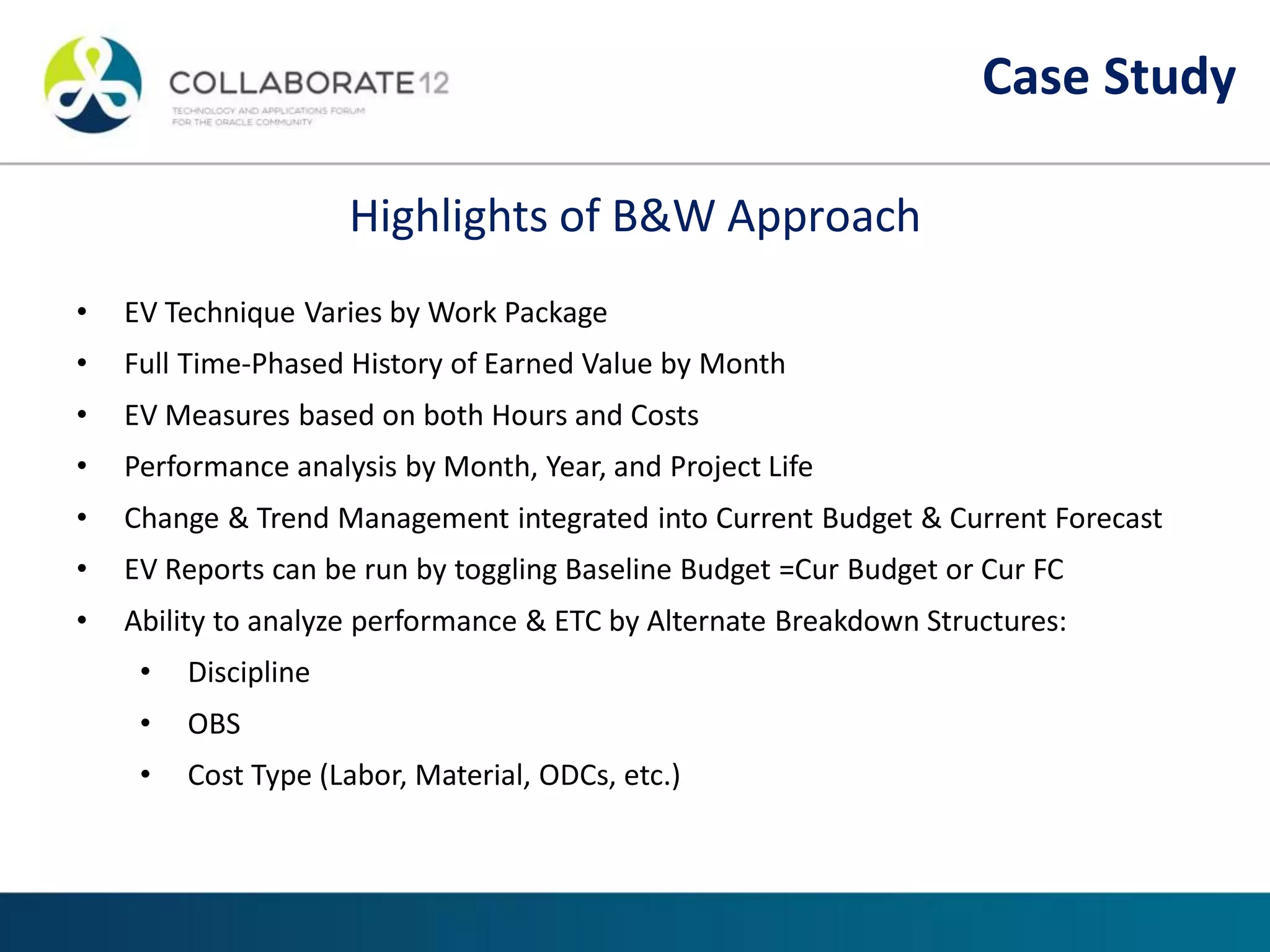

• EV Technique Varies by Work Package
• Full Time-Phased History of Earned Value by Month
• EV Measures based on both Hours and Costs
• Performance analysis by Month, Year, and Project Life
• Change & Trend Management integrated into Current Budget & Current Forecast
• EV Reports can be run by toggling Baseline Budget =Cur Budget or Cur FC
• Ability to analyze performance & ETC by Alternate Breakdown Structures:
• Discipline
• OBS
• Cost Type (Labor, Material, ODCs, etc.)
Highlights of B&W Approach
Case StudyCase Study

Cumulative & Periodic Performance
Standardized Performance
Reporting
Cumulative & Periodic Performance
Standardized Performance
Reporting

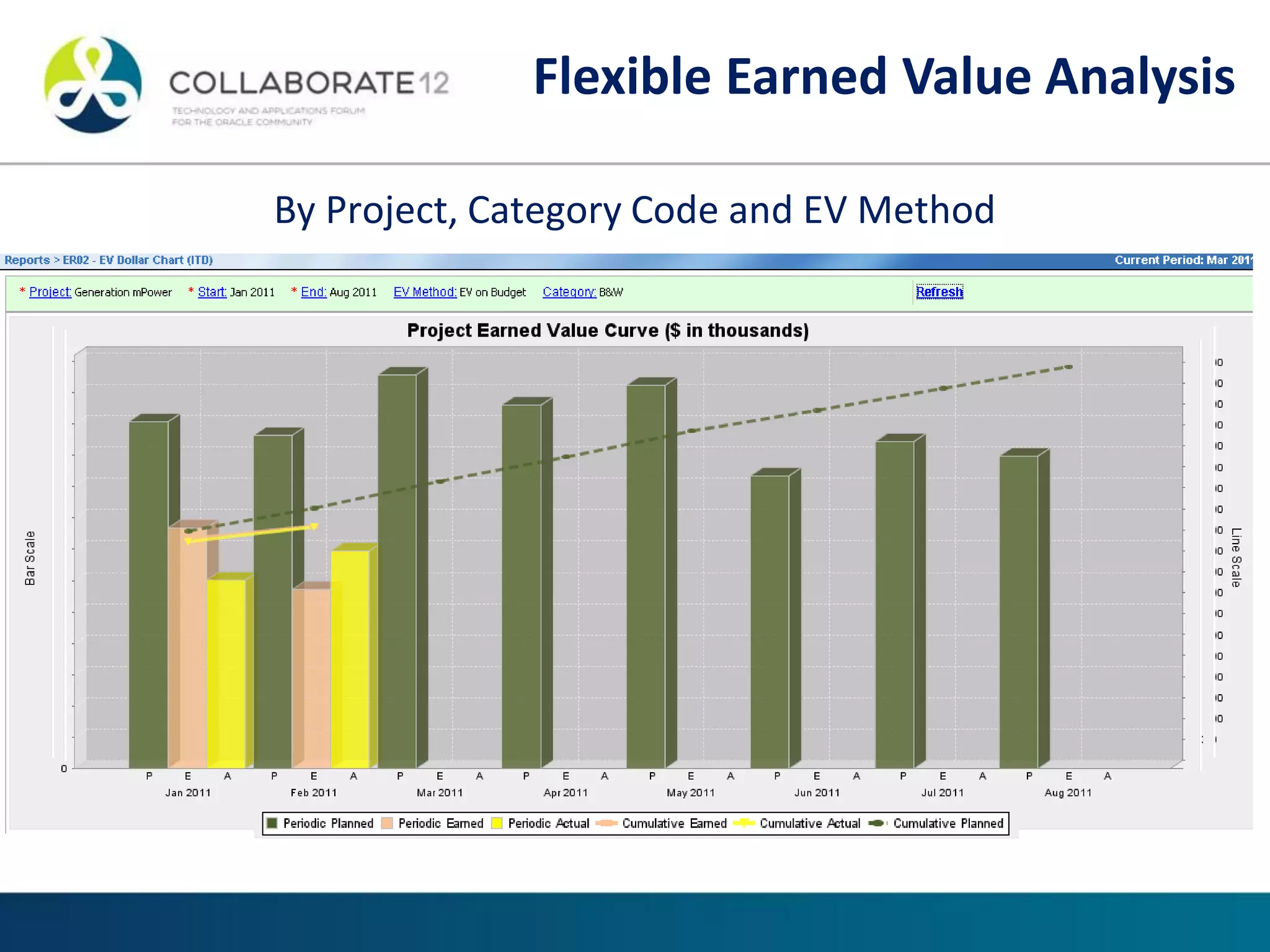

By Project, Category Code and EV Method
Flexible Earned Value Analysis

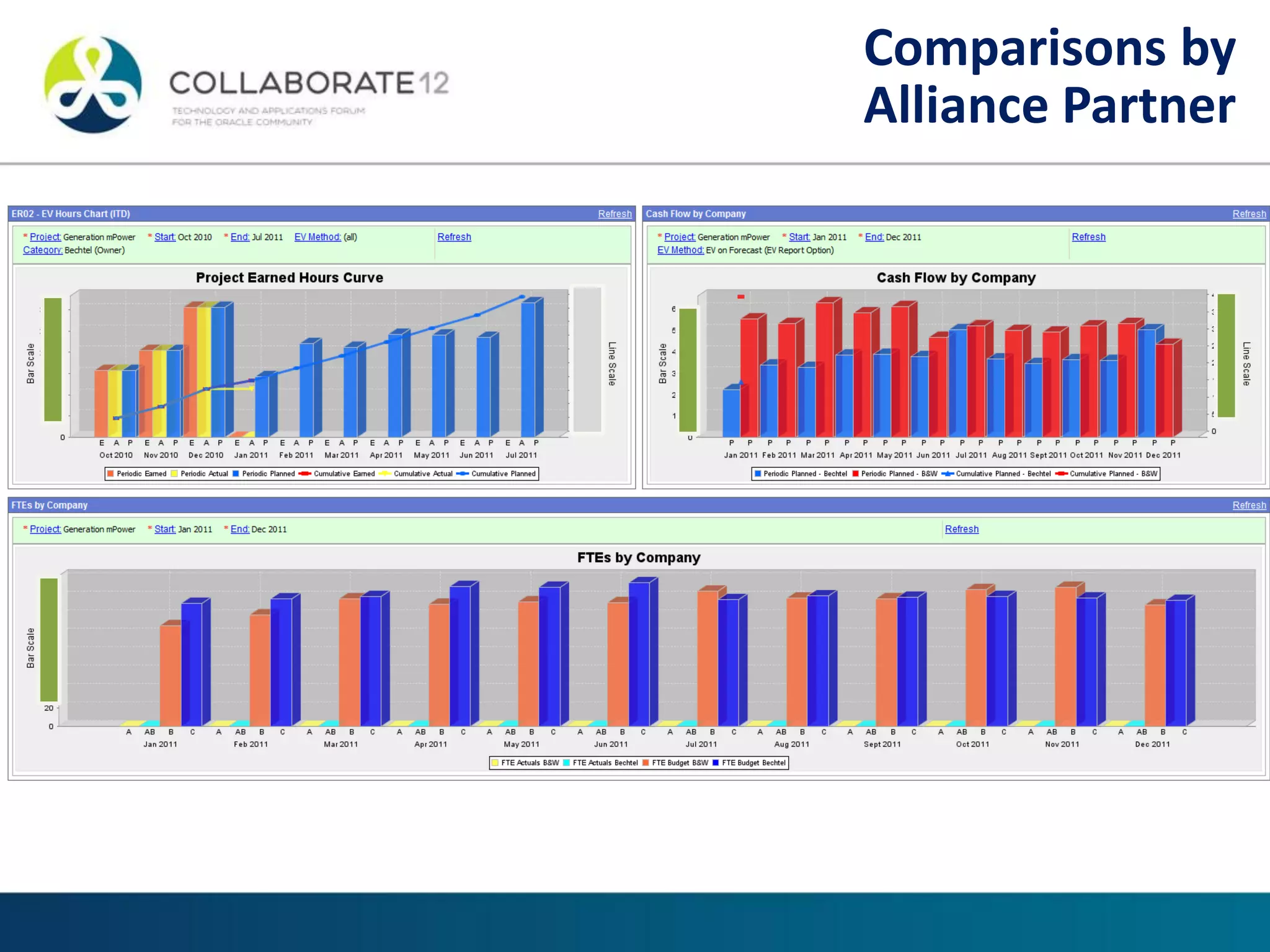

EVM DashboardsComparisons by
Alliance Partner

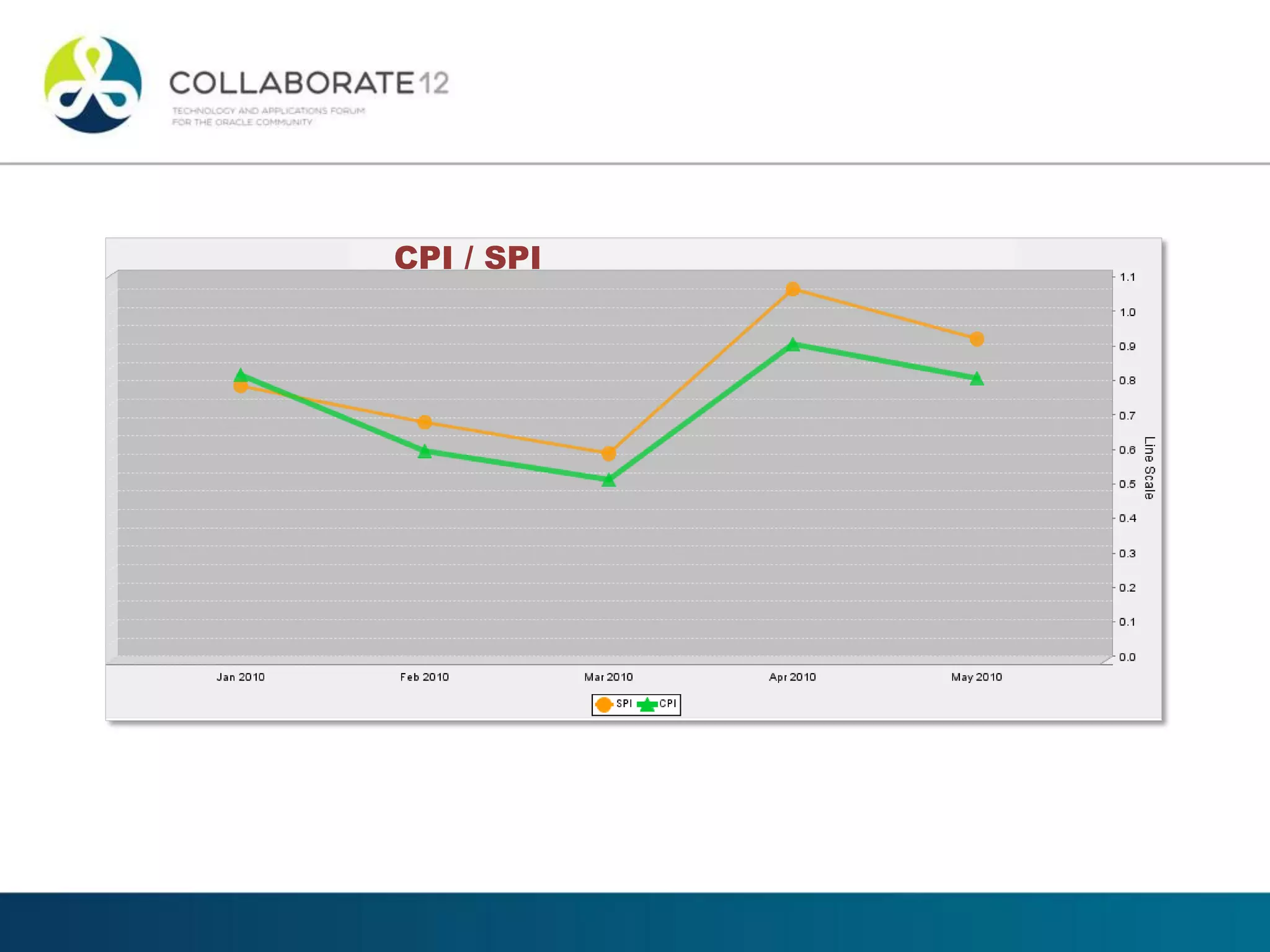

CPI / SPI

WBS and ABSWBS & CBS
– World leader in Project Management
and Engineering & Construction
in the Energy Industry
– Revenues of €6 Billion Annually
– 48 countries
– 27,000 people
32
Case Study

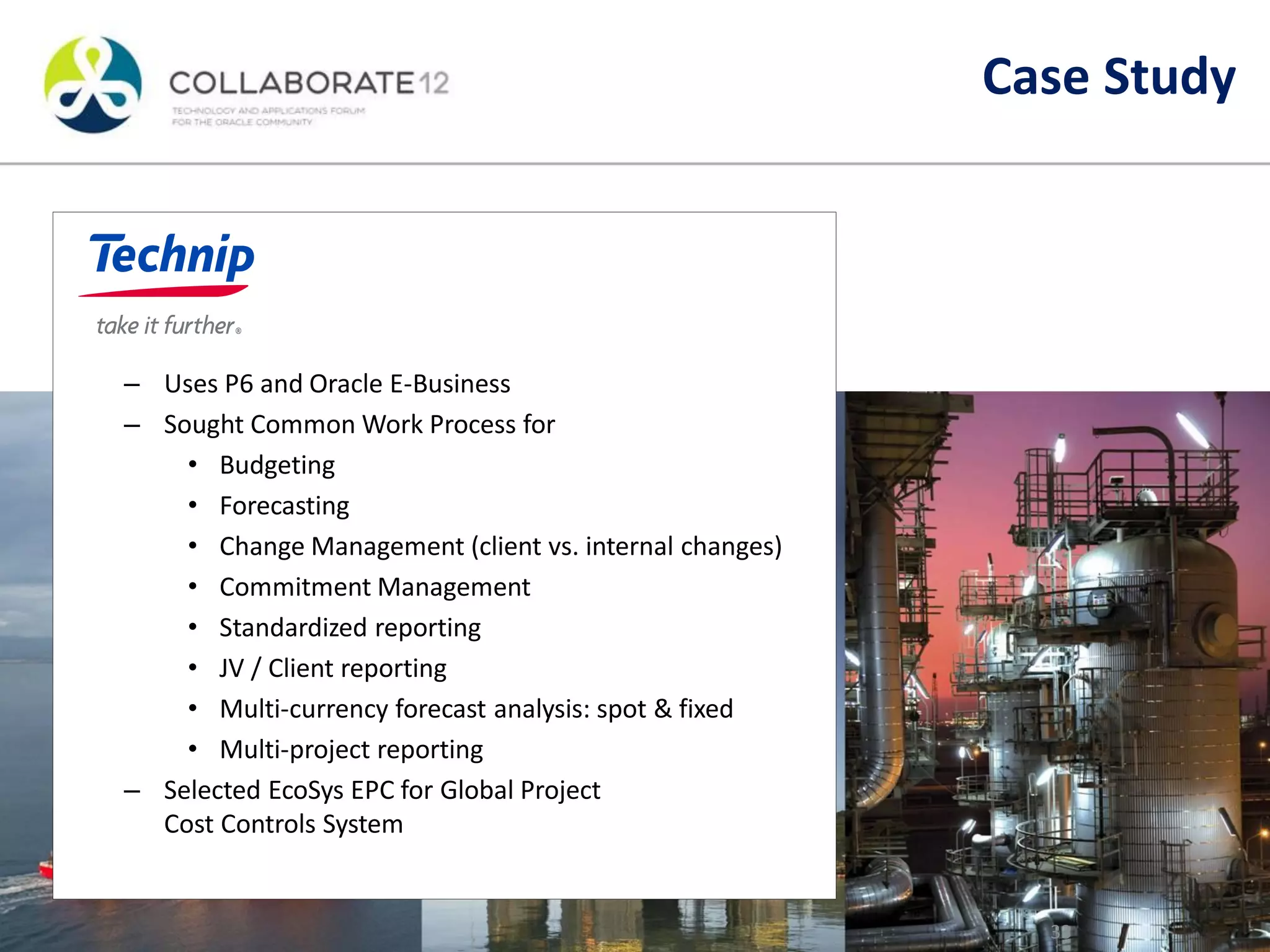

– Uses P6 and Oracle E-Business
– Sought Common Work Process for
• Budgeting
• Forecasting
• Change Management (client vs. internal changes)
• Commitment Management
• Standardized reporting
• JV / Client reporting
• Multi-currency forecast analysis: spot & fixed
• Multi-project reporting
– Selected EcoSys EPC for Global Project
Cost Controls System
33

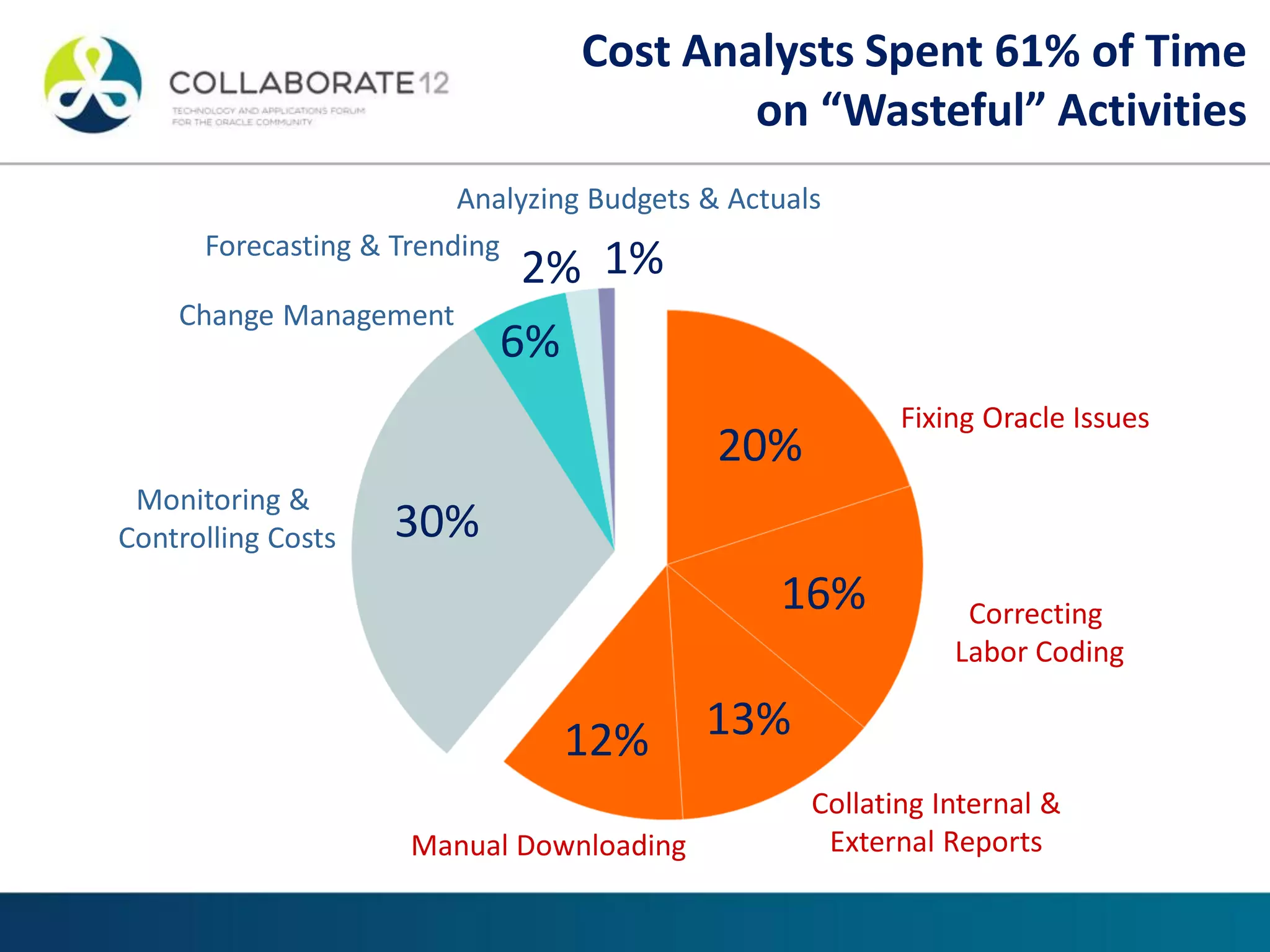

Case Study
20%
16%
13%12%
30%
6%
2% 1%
Fixing Oracle Issues
Correcting
Labor Coding
Collating Internal &
External ReportsManual Downloading
Monitoring &
Controlling Costs
Change Management
Forecasting & Trending
Analyzing Budgets & Actuals
Cost Analysts Spent 61% of Time
on “Wasteful” Activities

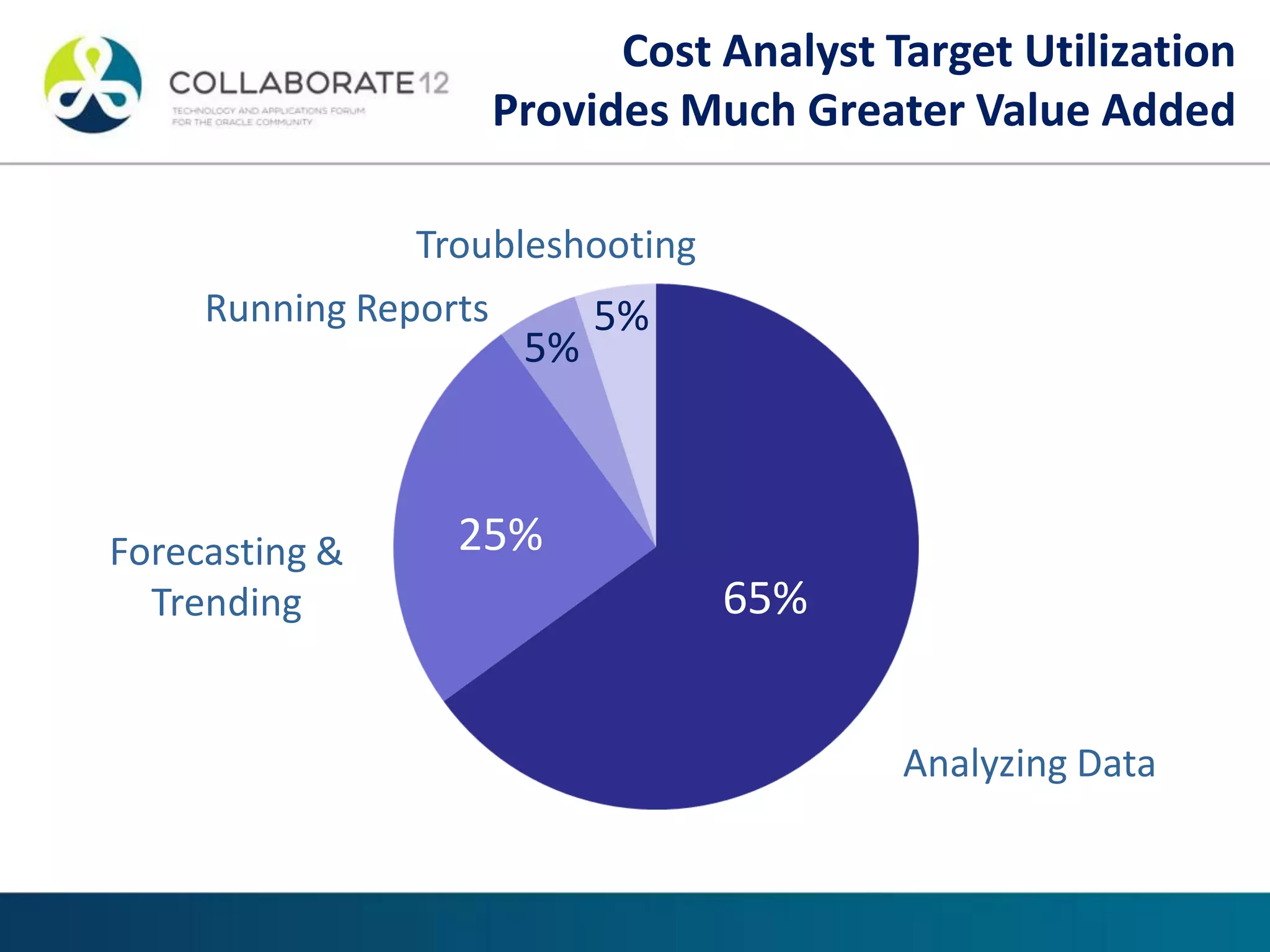

65%
25%
5%
5%
Analyzing Data
Forecasting &
Trending
Running Reports
Troubleshooting
Cost Analyst Target Utilization
Provides Much Greater Value Added
• Can be unique per Project
• Frees project teams to report
based on needs of project or
contract

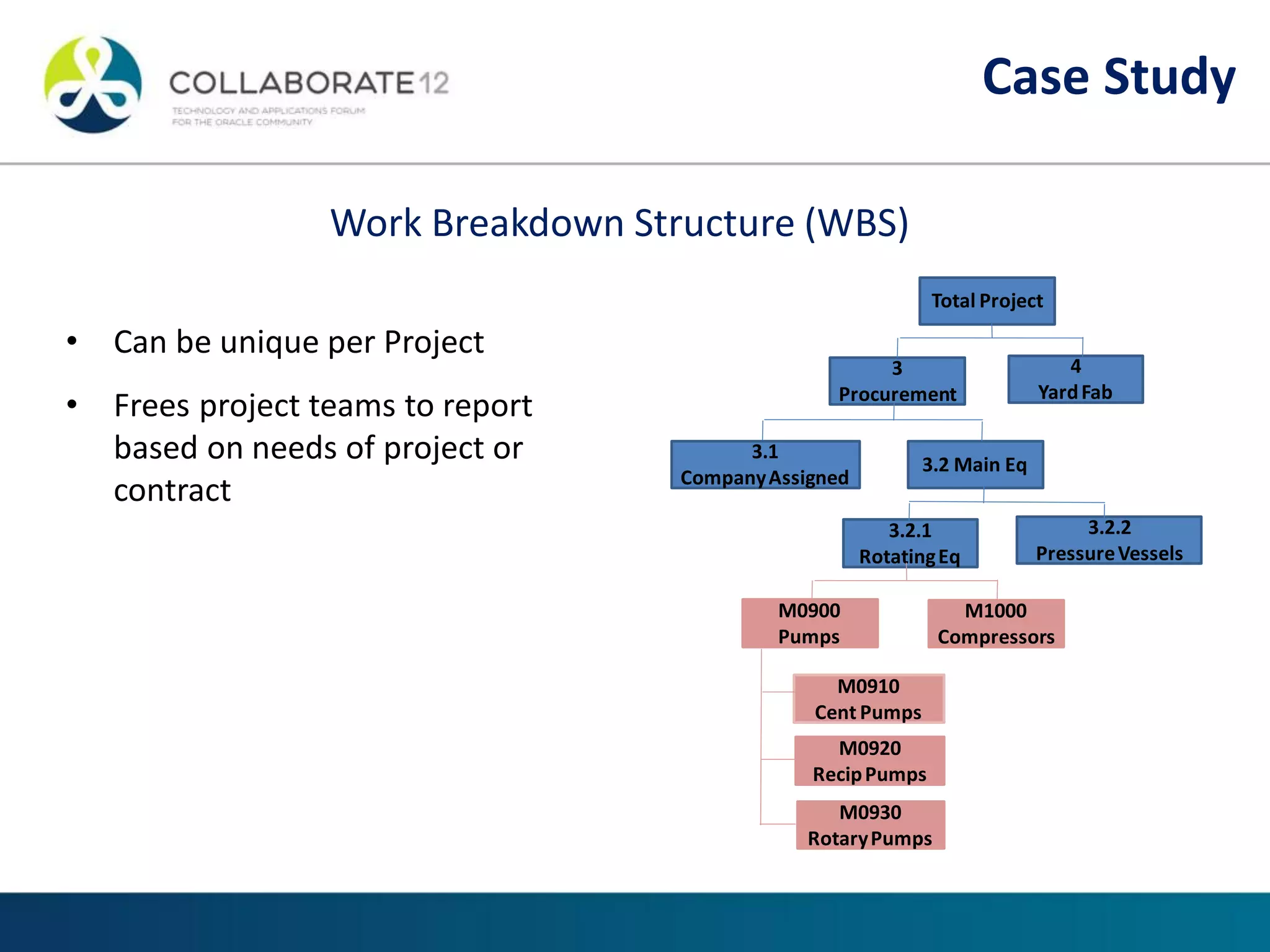

Work Breakdown Structure (WBS)
Total Project
M1000
Compressors
M0900
Pumps
3.2.2
PressureVessels
3.2.1
RotatingEq
3.2 Main Eq
3.1
CompanyAssigned
4
YardFab
3
Procurement
M0930
RotaryPumps
M0920
RecipPumps
M0910
Cent Pumps
Case Study
• Standardized Globally Via EPC
• Top Four Levels for Corporate Reporting
and Consolidation
• Levels 5+ Allow Regions Flexibility –
Typically broken out by Cost Types and
Disciplines
– Material Codes
– Construction Codes
– Financial/Accounting Codes
Corporate
Reporting
Dept. &
Financial
Codes
Common
Material
Codes
Common
Constr.
Codes
Work hours
Labor $
Material Quantities
Unit $
Total $
Work hours
Labor $
Total $

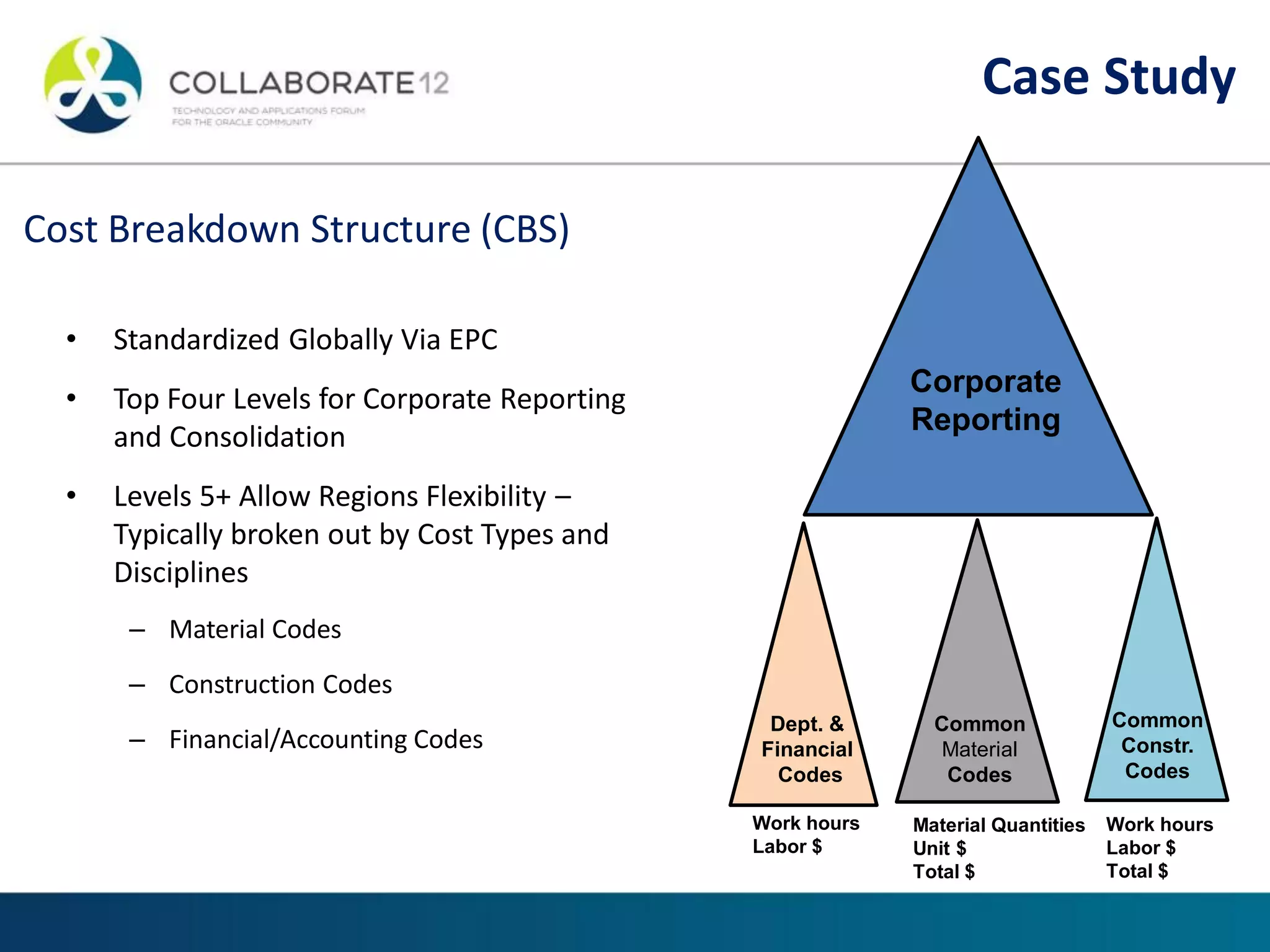

Cost Breakdown Structure (CBS)
Case Study

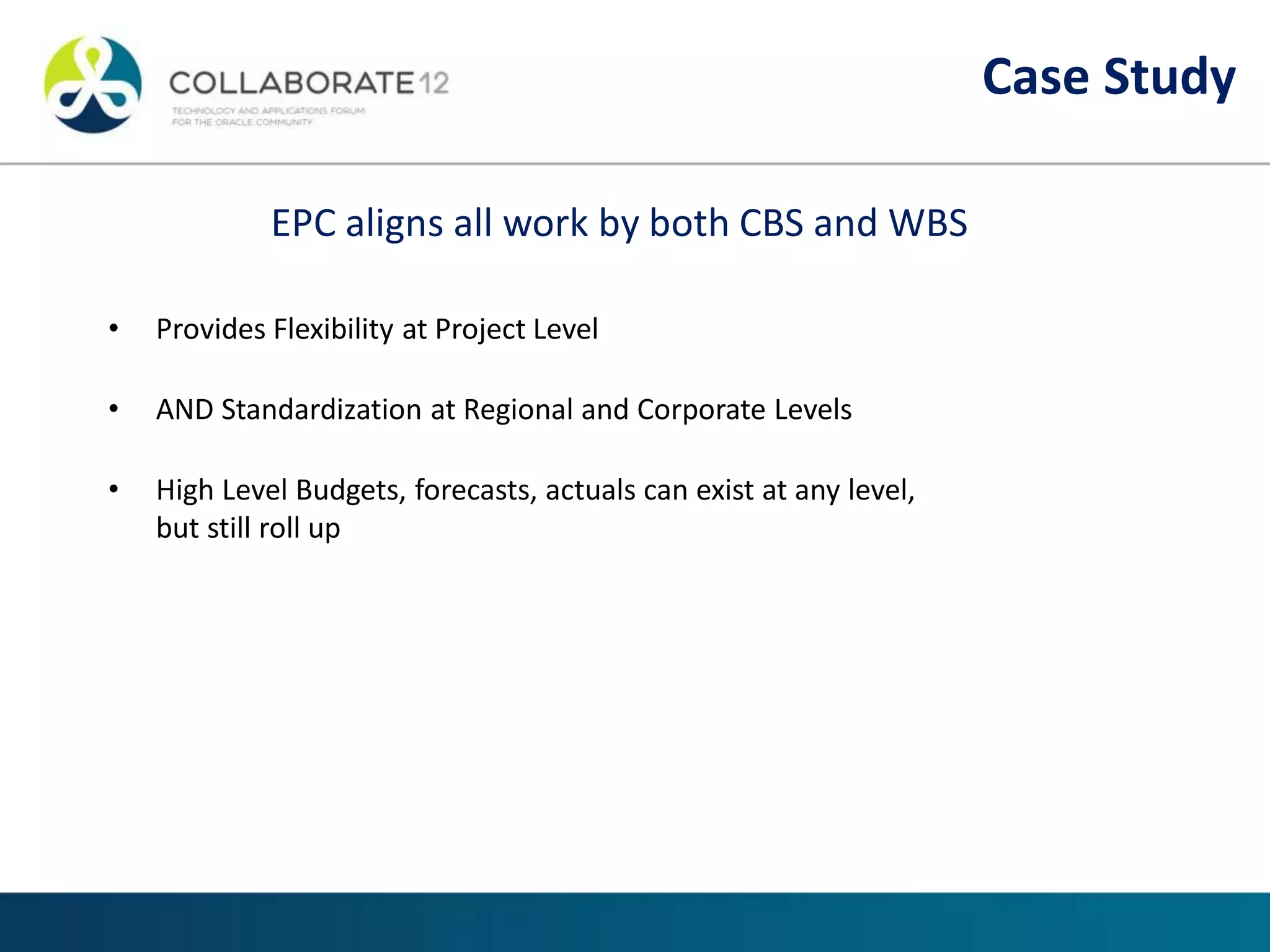

EPC aligns all work by both CBS and WBS
• Provides Flexibility at Project Level
• AND Standardization at Regional and Corporate Levels
• High Level Budgets, forecasts, actuals can exist at any level,
but still roll up
Case Study

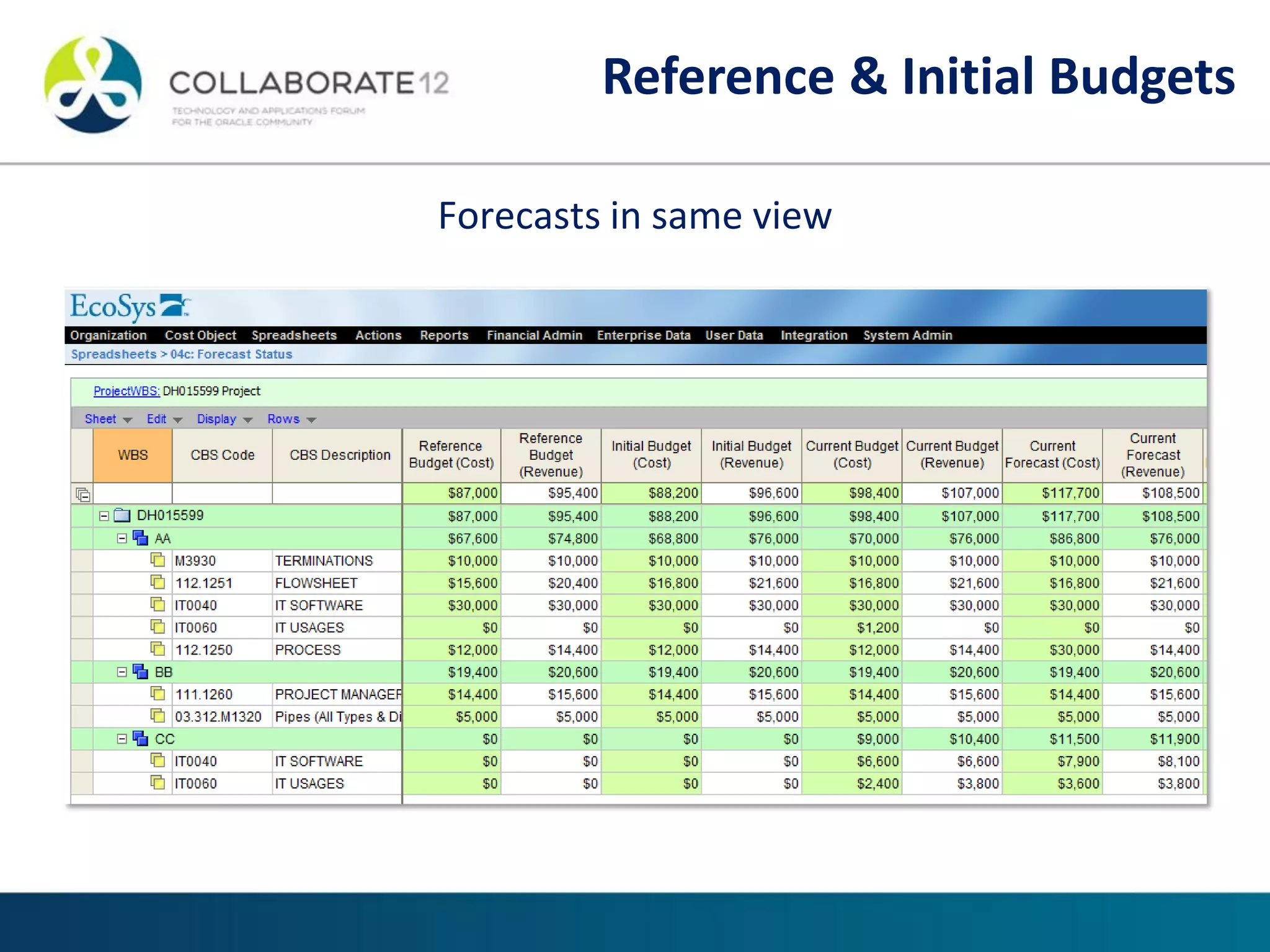

Forecasts in same view
Reference & Initial Budgets

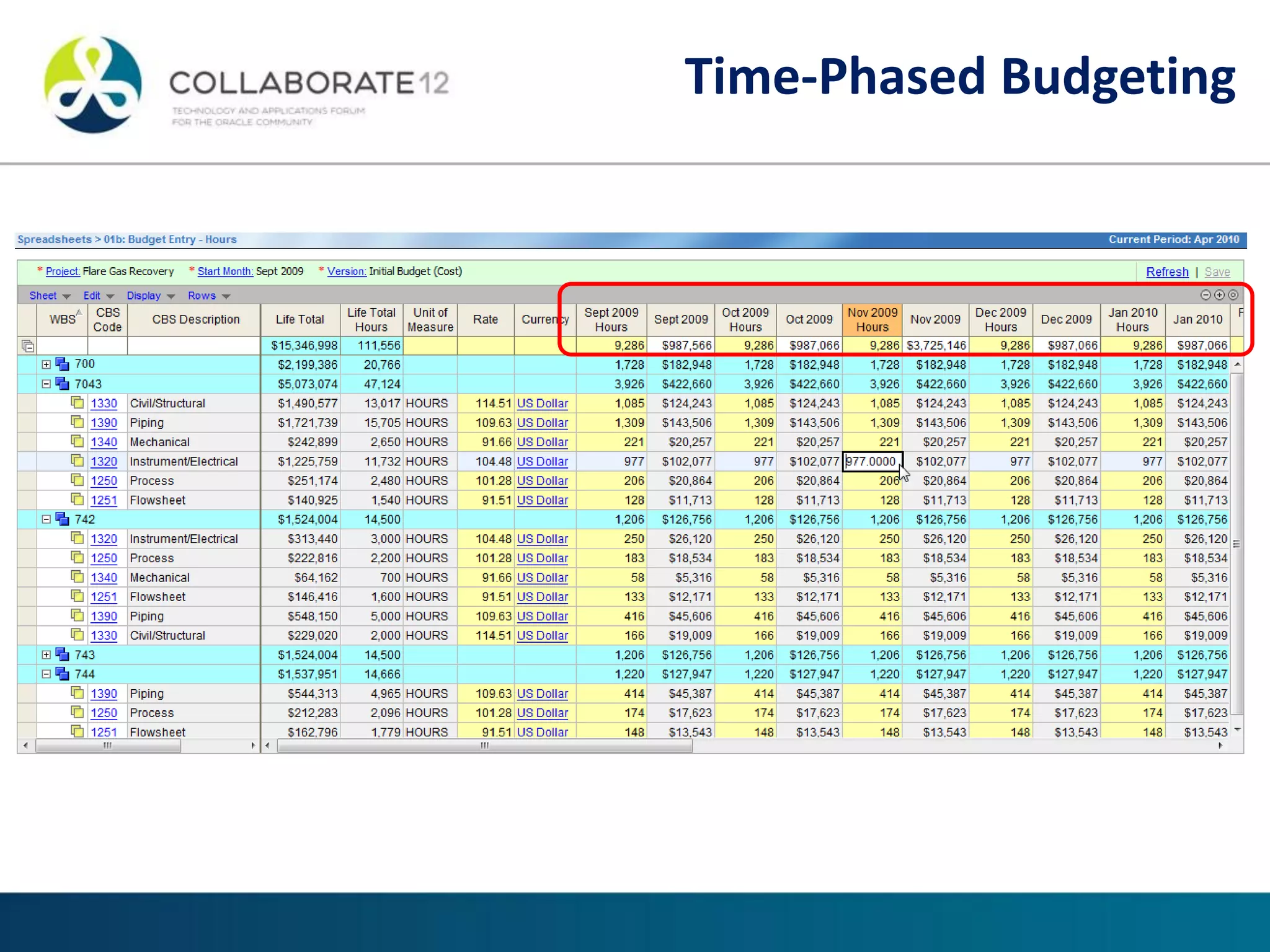

Time-Phased Budgeting

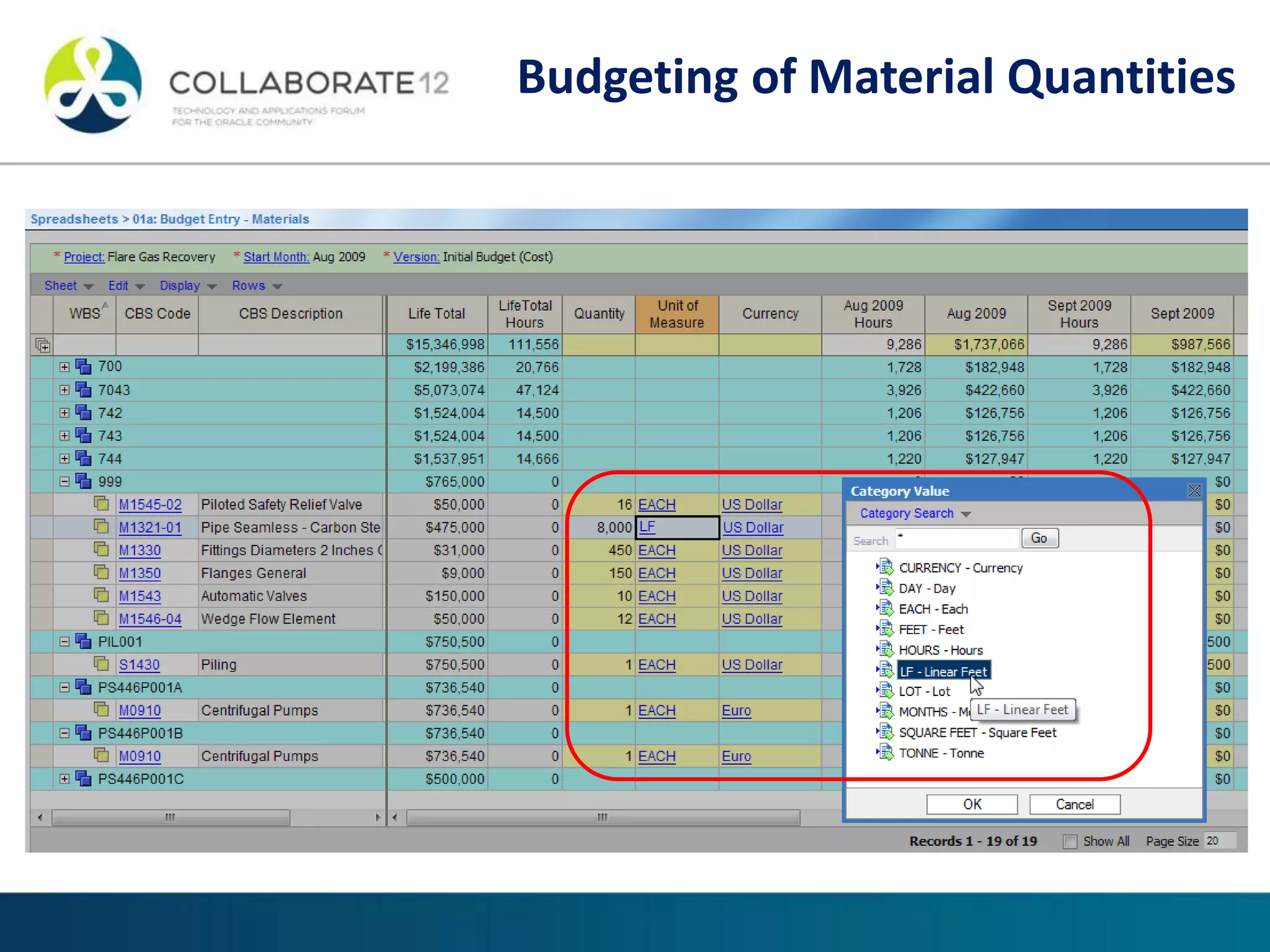

Budgeting of Material Quantities
Visibility

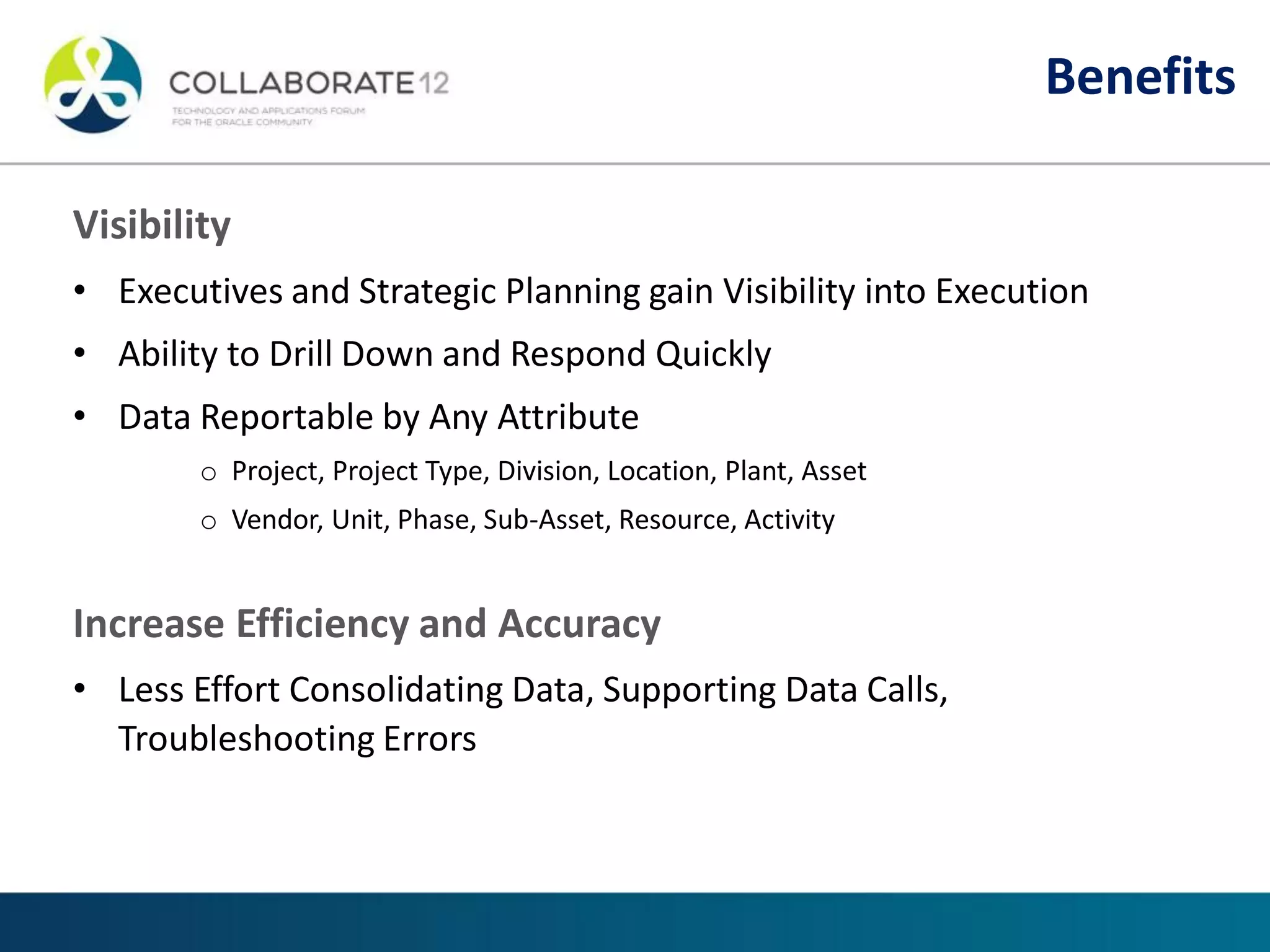

• Executives and Strategic Planning gain Visibility into Execution
• Ability to Drill Down and Respond Quickly
• Data Reportable by Any Attribute
o Project, Project Type, Division, Location, Plant, Asset
o Vendor, Unit, Phase, Sub-Asset, Resource, Activity
Increase Efficiency and Accuracy
• Less Effort Consolidating Data, Supporting Data Calls,
Troubleshooting Errors
Benefits

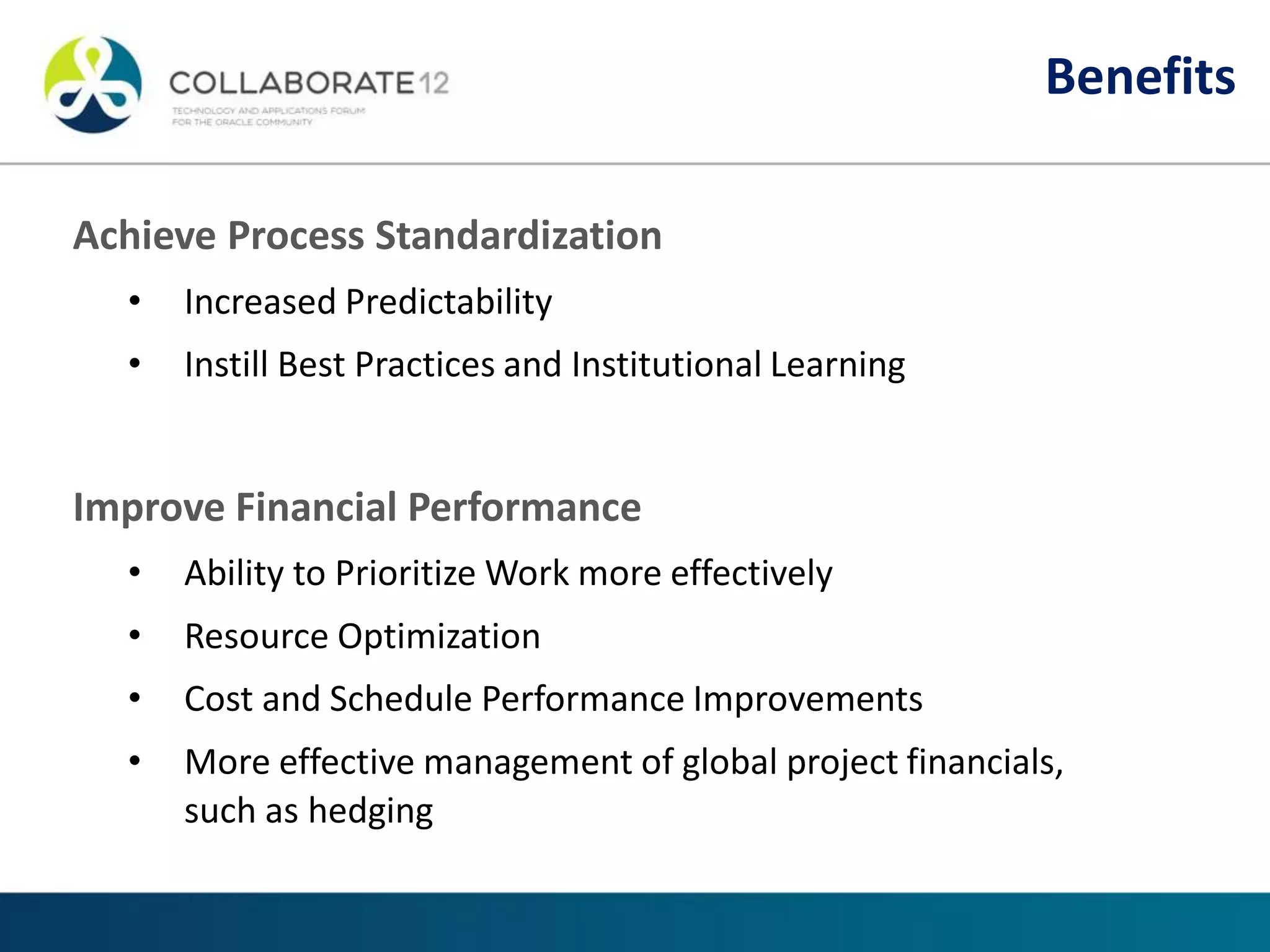

Achieve Process Standardization
• Increased Predictability
• Instill Best Practices and Institutional Learning
Improve Financial Performance
• Ability to Prioritize Work more effectively
• Resource Optimization
• Cost and Schedule Performance Improvements
• More effective management of global project financials,
such as hedging
Benefits
Questions?
Thanks!

Bridging the cost schedule divide - integrating primavera and cost systems ppt

  • 1.
    Bridging the Cost/ScheduleDivide: Integrating Primavera and Cost Systems Javier Sloninsky EcoSys
  • 2.
    Agenda Speaker intro Corporate Introduction TheChallenges of the Cost / Schedule Divide Best Practices and Case Studies in Cost Integration with Oracle Primavera: • Elements of a “Best Practices” Cost Controls Solution • Case Study: B&W • Case Study: Technip Benefits Q&A
  • 3.
    Founded in 2000 EnterpriseProject Controls Software Experts Designers & Developers of original Primavera P6 and EcoSys EPC Professional Services Enterprise Consulting Expertise: Project Portfolio & Cost Management Best Practices Global Primavera Implementation and Systems Integration Leader Partnerships with Oracle, SAP, Accenture, Microsoft, IBM 250 Customers in Global 1000 and Public Sector EcoSys Company Background
  • 4.
    • Project ControlsSystem Designers • Project Controls Implementers: – Owners and Operators – Contractors – Public sector • Enterprise architecture mindset • Partnership approach with industry • Constant evolution Our Perspective Our Perspective
  • 5.
  • 6.
    6 EcoSys EPC Certifiedto run seamlessly with Oracle and SAP: Professional Partnerships with Global Tech Leaders: Global Technology Partners
  • 7.
    The Cost/Schedule Divide CostSchedule • Control • Structure • Auditable • Dynamic • Flexible ?
  • 8.
    In most organizations,Cost Controls is not a simple affair Departmental Budgets Project ForecastsProject Budgets Actual TransactionsCommitments Contract Database Project Planning General LedgerGeneral Ledger Time Cards JVFunding Funds Management Impact • Teams of people consolidating data in spreadsheets • Double entry • Spreadsheet errors • Performance reports available too late to address issues Challenges for Cost Controls
  • 9.
    Strike a balancebetween flexibility and business rule enforcement Tailorability /Configurability  Terminology  Processes  Reporting  Metrics Project/Cost Structures  WBS  CBS  OBS  Alternate Breakdown Structures  Phases/Lifecycle Financial data structures  Actual Expenditures  Accruals  Revenue  Commitments  Pricing & Rates  Multi-currency Project schedule data  WBS  Cash Flows / Time Phasing  Time Periods  Resource loading Successful Cost Controls Systems
  • 10.
  • 11.
  • 12.
    • Import Projects/WBSfrom P6 • Import Resources • Import Dates • Import % Complete • Import time-phased Resource Assignments – Units (BL, actuals, planned, remaining) – Costs (BL, actuals, planned, remaining) • Import/Map P6 Codes/Attributes – Project Codes – Resource Codes – Activity Codes – Cost Accounts – Expense Categories Different integration rules can be established for different business areas, departments, project types, etc • Export Projects, Activities to P6 • Export Actuals – Units – Costs – Resources – Dates – Map to WBS/Activity Codes/Roles • Export Forecasts – Units – Costs – Resources – Dates – % Complete – Map to WBS/Activity Codes/Roles Flexible Primavera Integration Options
  • 13.
    Create Projects and BuildWBS in EcoSys, or import from Primavera, or other systems. Budget in EcoSys, or Import from Primavera, Oracle Projects, etc. Actuals from General Ledger and/or from Accruals Import Commitments or Manage in EcoSys Progress and Forecast in EcoSys, and compare to cost loaded schedules, contractor forecasts Maintain Each Version in EcoSys, gaining Trending and Audit Trail Planning & Controls Platform
  • 14.
    Departments/Programs > Program> Project > Transactions Full Drilldown Visibility
  • 15.
    Project Budgeting Project Forecasting ContractCommitments Planning Customizable Web Spreadsheets for data entry
  • 16.
  • 17.
  • 18.
    Can set upcompany specific custom criteria: • Group By Capital and O&M • Filter by Outage/Online • Distribute cost manually or by curve Configurable Cost Processes
  • 19.
  • 20.
  • 21.
    • Babcock &Wilcox, Nuclear Power Generation company, establishes EVM standards and reporting mechanisms • Technip Project Cost Management System integrating systems for global standard project controls Project Controls Best Practices
  • 22.
    • Nuclear PowerGeneration & Operations company with major R&D, Construction, and Services projects in US & Canada • Also in Alliance with Bechtel for Modular Nuclear Reactor technology • Standardized on SAP and Primavera P6 • Selected EcoSys for integrated earned value performance management, project reporting, and controls • Expanded EcoSys for Outage Reporting in 2012 Case Study
  • 23.
    WBS & WBSStatus Budgets, Forecasts Integrated Earned Value Mgmt Budgets & Forecasts Commitments Actual Costs, Revenue Change Orders Project Cost Reporting Historical Snapshots Transaction/Audit Repository Projects, WBS Dates Labor plans Percent Complete Actual Costs Timesheets Commitments Revenue Case Study Timesheets Case Study Integration Approach
  • 24.
    • EV TechniqueVaries by Work Package • Full Time-Phased History of Earned Value by Month • EV Measures based on both Hours and Costs • Performance analysis by Month, Year, and Project Life • Change & Trend Management integrated into Current Budget & Current Forecast • EV Reports can be run by toggling Baseline Budget =Cur Budget or Cur FC • Ability to analyze performance & ETC by Alternate Breakdown Structures: • Discipline • OBS • Cost Type (Labor, Material, ODCs, etc.) Highlights of B&W Approach Case StudyCase Study
  • 25.
    Cumulative & PeriodicPerformance Standardized Performance Reporting
  • 26.
    Cumulative & PeriodicPerformance Standardized Performance Reporting
  • 27.
    By Project, CategoryCode and EV Method Flexible Earned Value Analysis
  • 28.
  • 29.
  • 30.
  • 31.
    – World leaderin Project Management and Engineering & Construction in the Energy Industry – Revenues of €6 Billion Annually – 48 countries – 27,000 people 32 Case Study
  • 32.
    – Uses P6and Oracle E-Business – Sought Common Work Process for • Budgeting • Forecasting • Change Management (client vs. internal changes) • Commitment Management • Standardized reporting • JV / Client reporting • Multi-currency forecast analysis: spot & fixed • Multi-project reporting – Selected EcoSys EPC for Global Project Cost Controls System 33 Case Study
  • 33.
    20% 16% 13%12% 30% 6% 2% 1% Fixing OracleIssues Correcting Labor Coding Collating Internal & External ReportsManual Downloading Monitoring & Controlling Costs Change Management Forecasting & Trending Analyzing Budgets & Actuals Cost Analysts Spent 61% of Time on “Wasteful” Activities
  • 34.
    65% 25% 5% 5% Analyzing Data Forecasting & Trending RunningReports Troubleshooting Cost Analyst Target Utilization Provides Much Greater Value Added
  • 35.
    • Can beunique per Project • Frees project teams to report based on needs of project or contract Work Breakdown Structure (WBS) Total Project M1000 Compressors M0900 Pumps 3.2.2 PressureVessels 3.2.1 RotatingEq 3.2 Main Eq 3.1 CompanyAssigned 4 YardFab 3 Procurement M0930 RotaryPumps M0920 RecipPumps M0910 Cent Pumps Case Study
  • 36.
    • Standardized GloballyVia EPC • Top Four Levels for Corporate Reporting and Consolidation • Levels 5+ Allow Regions Flexibility – Typically broken out by Cost Types and Disciplines – Material Codes – Construction Codes – Financial/Accounting Codes Corporate Reporting Dept. & Financial Codes Common Material Codes Common Constr. Codes Work hours Labor $ Material Quantities Unit $ Total $ Work hours Labor $ Total $ Cost Breakdown Structure (CBS) Case Study
  • 37.
    EPC aligns allwork by both CBS and WBS • Provides Flexibility at Project Level • AND Standardization at Regional and Corporate Levels • High Level Budgets, forecasts, actuals can exist at any level, but still roll up Case Study
  • 38.
    Forecasts in sameview Reference & Initial Budgets
  • 39.
  • 40.
  • 41.
    Visibility • Executives andStrategic Planning gain Visibility into Execution • Ability to Drill Down and Respond Quickly • Data Reportable by Any Attribute o Project, Project Type, Division, Location, Plant, Asset o Vendor, Unit, Phase, Sub-Asset, Resource, Activity Increase Efficiency and Accuracy • Less Effort Consolidating Data, Supporting Data Calls, Troubleshooting Errors Benefits
  • 42.
    Achieve Process Standardization •Increased Predictability • Instill Best Practices and Institutional Learning Improve Financial Performance • Ability to Prioritize Work more effectively • Resource Optimization • Cost and Schedule Performance Improvements • More effective management of global project financials, such as hedging Benefits
  • 43.
