Copyright © 2016 Oracle and/or its affiliates. All rights reserved.
Primavera Gateway
16 Release 1 – March 2016
John Pikovskiy
Director
Oracle
Primavera Product Strategy
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.

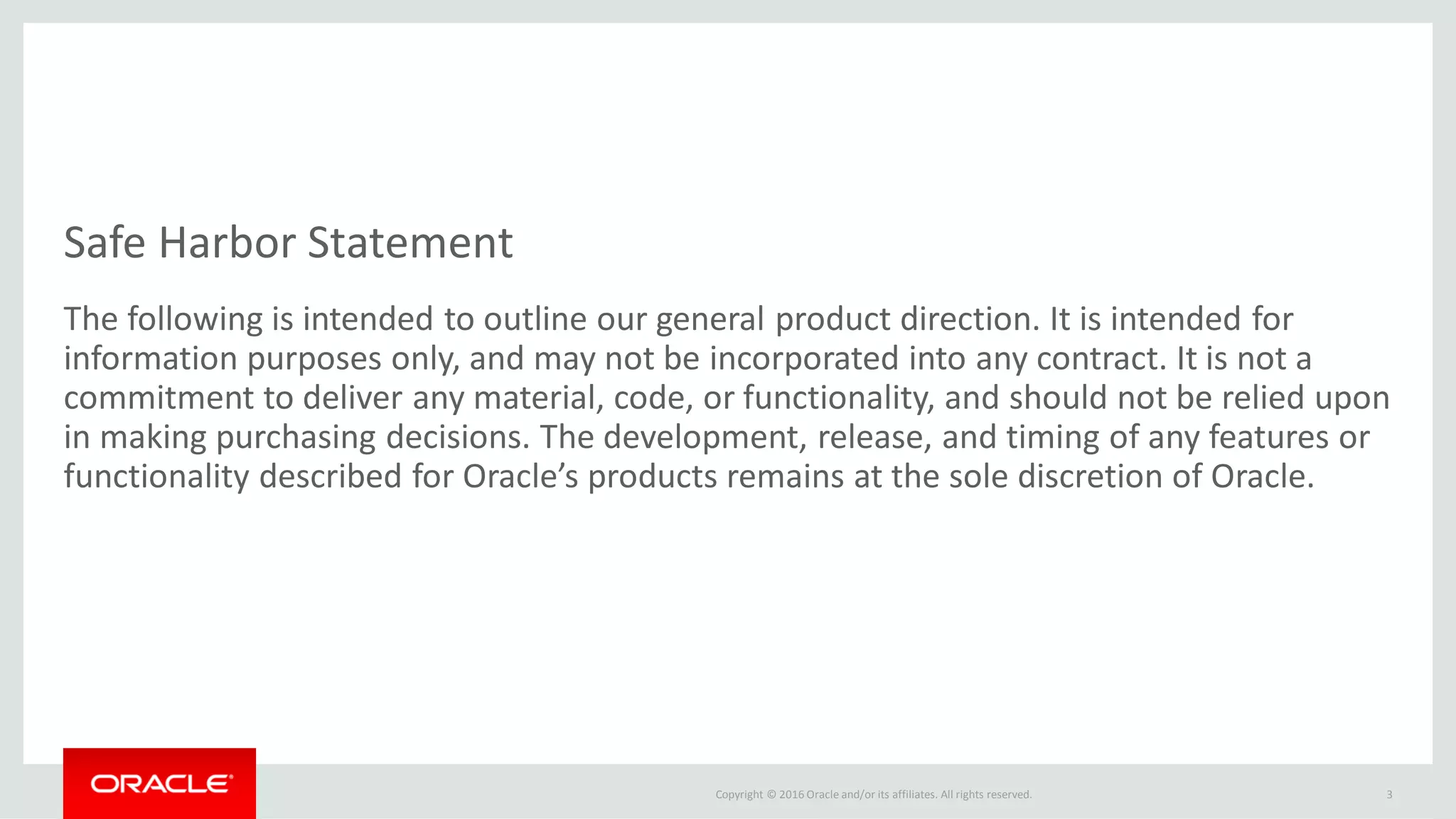

Safe Harbor Statement
The following is intended to outline our general product direction. It is intended for
information purposes only, and may not be incorporated into any contract. It is not a
commitment to deliver any material, code, or functionality, and should not be relied upon
in making purchasing decisions. The development, release, and timing of any features or
functionality described for Oracle’s products remains at the sole discretion of Oracle.
3
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.

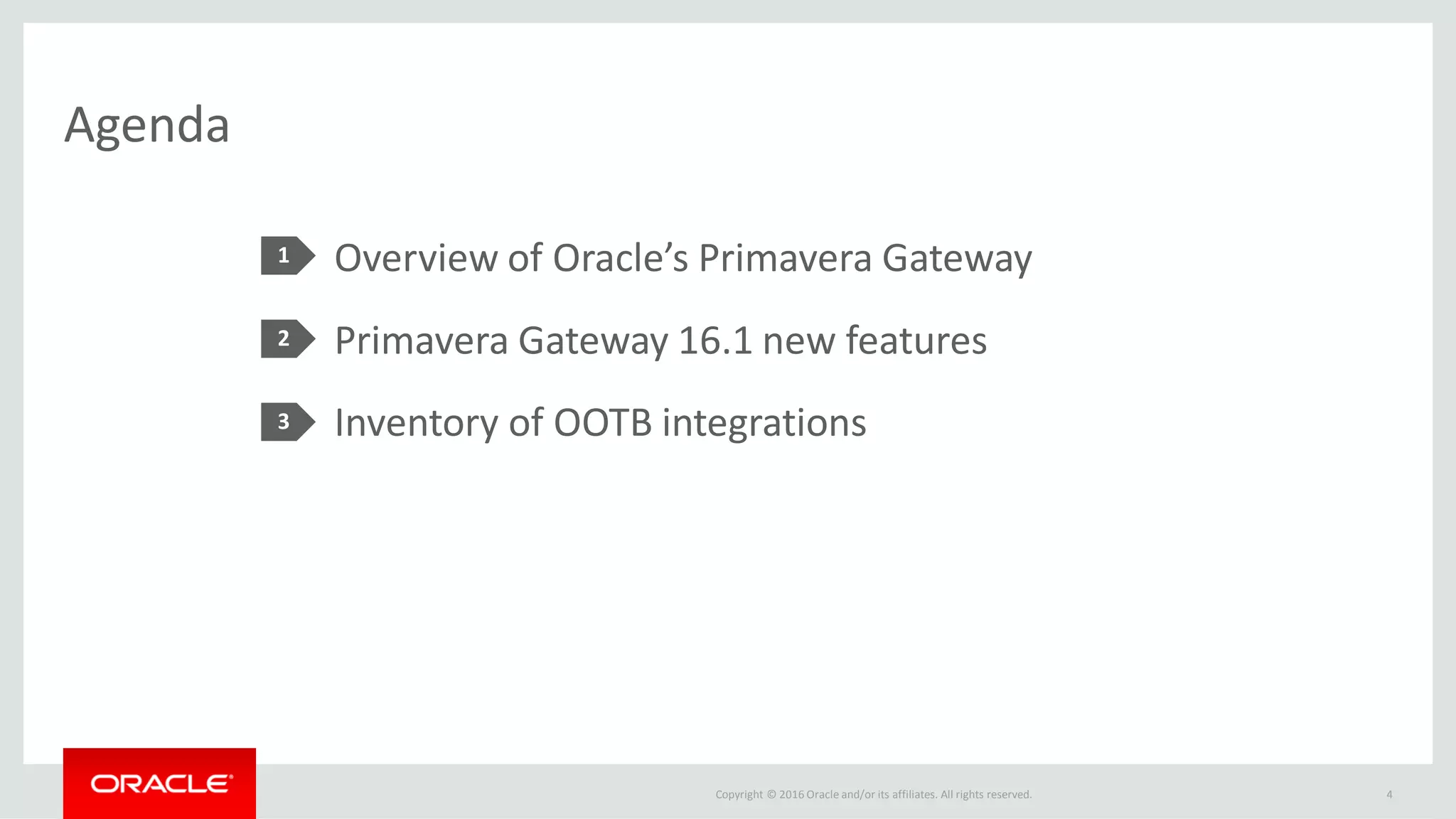

Agenda
Overview of Oracle’s Primavera Gateway
Primavera Gateway 16.1 new features
Inventory of OOTB integrations
1
2
3
4
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.
Overview
Primavera Gateway
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.

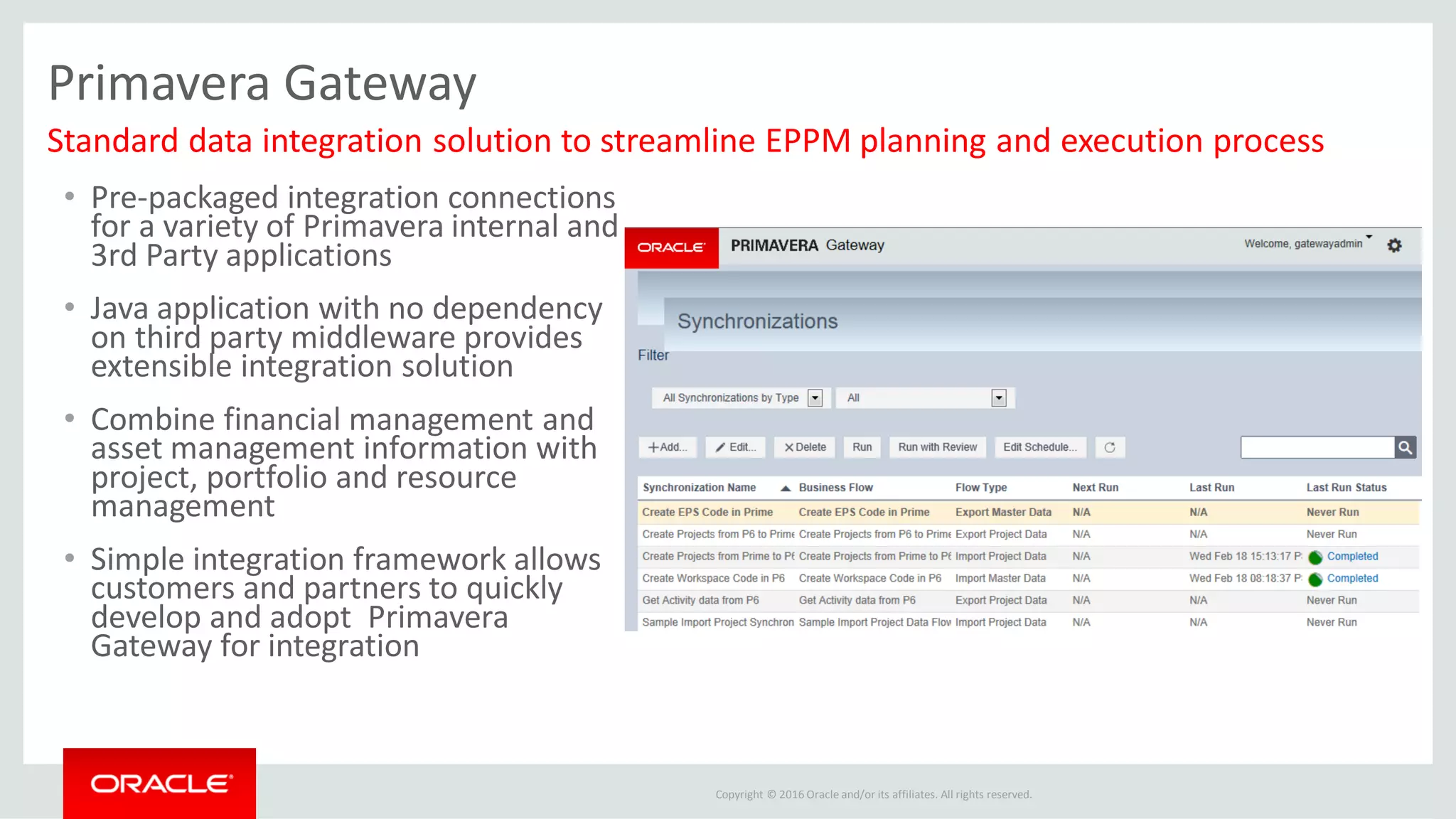

Primavera Gateway
• Pre-packaged integration connections
for a variety of Primavera internal and
3rd Party applications
• Java application with no dependency
on third party middleware provides
extensible integration solution
• Combine financial management and
asset management information with
project, portfolio and resource
management
• Simple integration framework allows
customers and partners to quickly
develop and adopt Primavera
Gateway for integration
Standard data integration solution to streamline EPPM planning and execution process
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.
Pre-built
Primavera
Gateway
Partner’s ,
Competitors
Custom
WS / API
SOA , ICS,
Non-Oracle ,
Legacy
Integration Options
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.

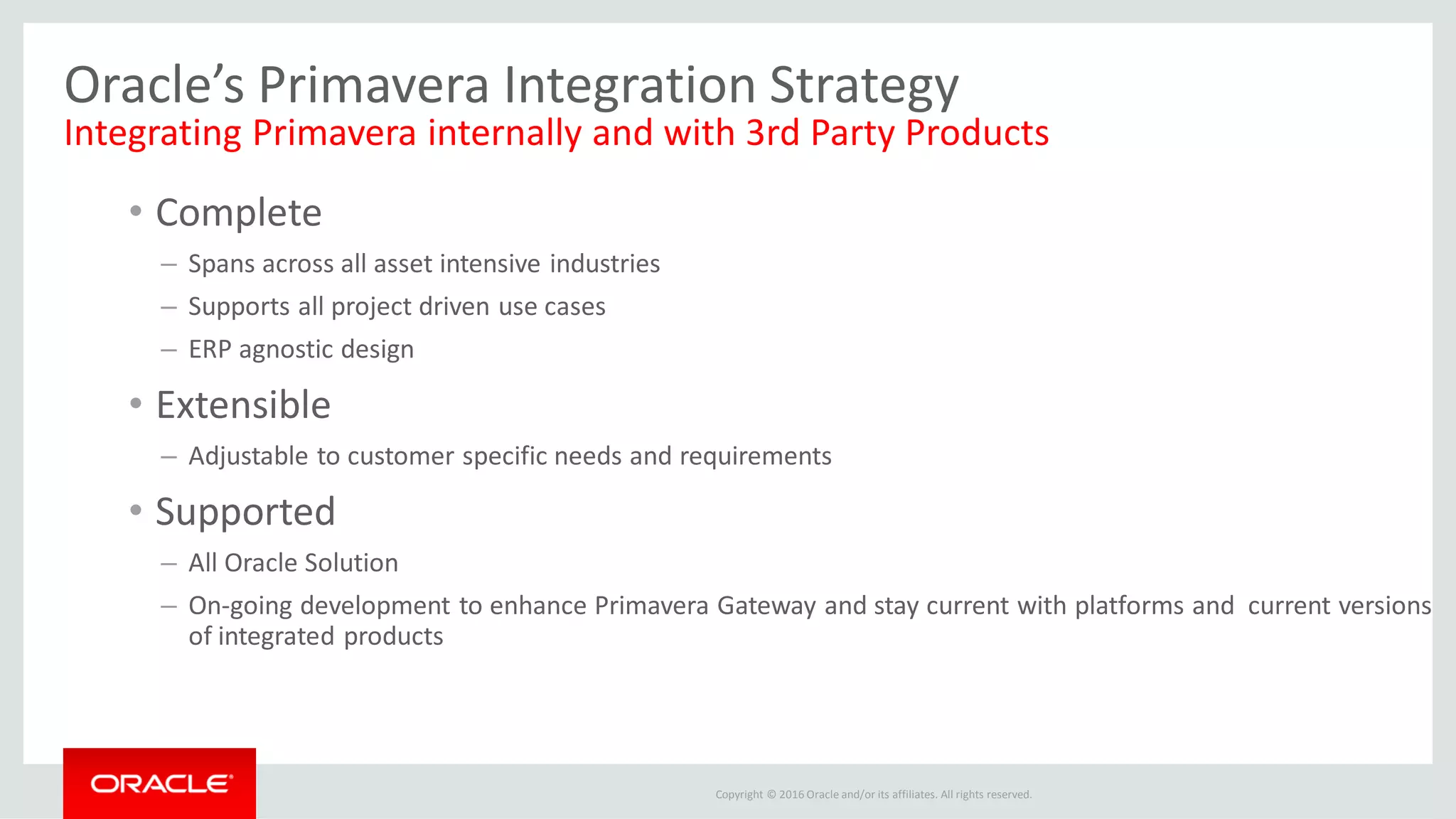

Oracle’s Primavera Integration Strategy
Integrating Primavera internally and with 3rd Party Products
• Complete
– Spans across all asset intensive industries
– Supports all project driven use cases
– ERP agnostic design
• Extensible
– Adjustable to customer specific needs and requirements
• Supported
– All Oracle Solution
– On-going development to enhance Primavera Gateway and stay current with platforms and current versions
of integrated products
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.

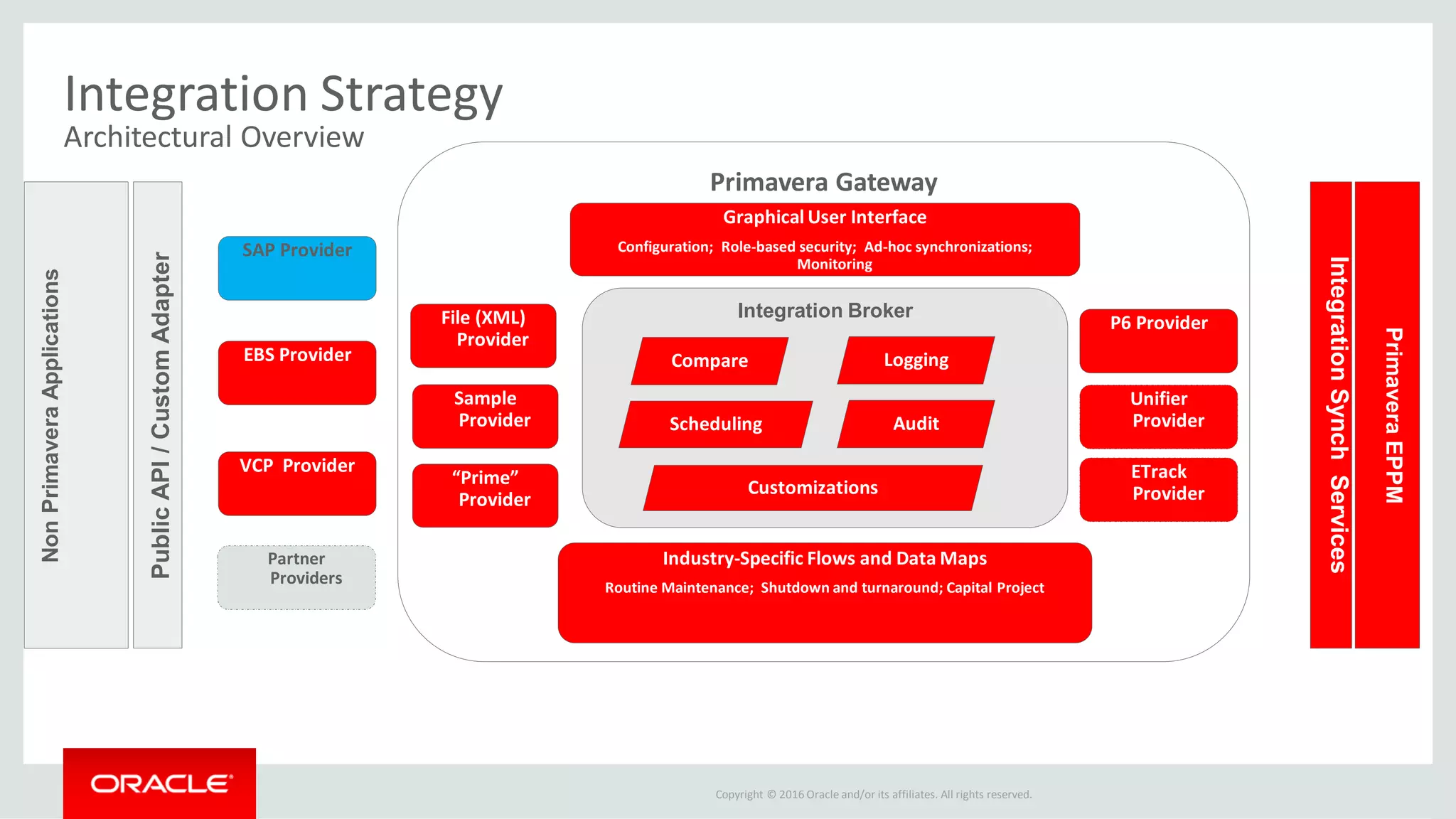

Integration Strategy
Architectural Overview
Primavera Gateway
NonPrimaveraApplications
PrimaveraEPPM
Integration Broker
Graphical User Interface
Configuration; Role-based security; Ad-hoc synchronizations;
Monitoring
SAP Provider
Unifier
Provider
EBS Provider
VCP Provider
P6 Provider
PublicAPI/CustomAdapter
IntegrationSynchServices
Compare
Industry-Specific Flows and Data Maps
Routine Maintenance; Shutdown and turnaround; Capital Project
Logging
Scheduling Audit
Customizations
Sample
Provider
ETrack
Provider
“Prime”
Provider
Partner
Providers
File (XML)
Provider
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.
Today
Primavera Gateway 16.1
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.

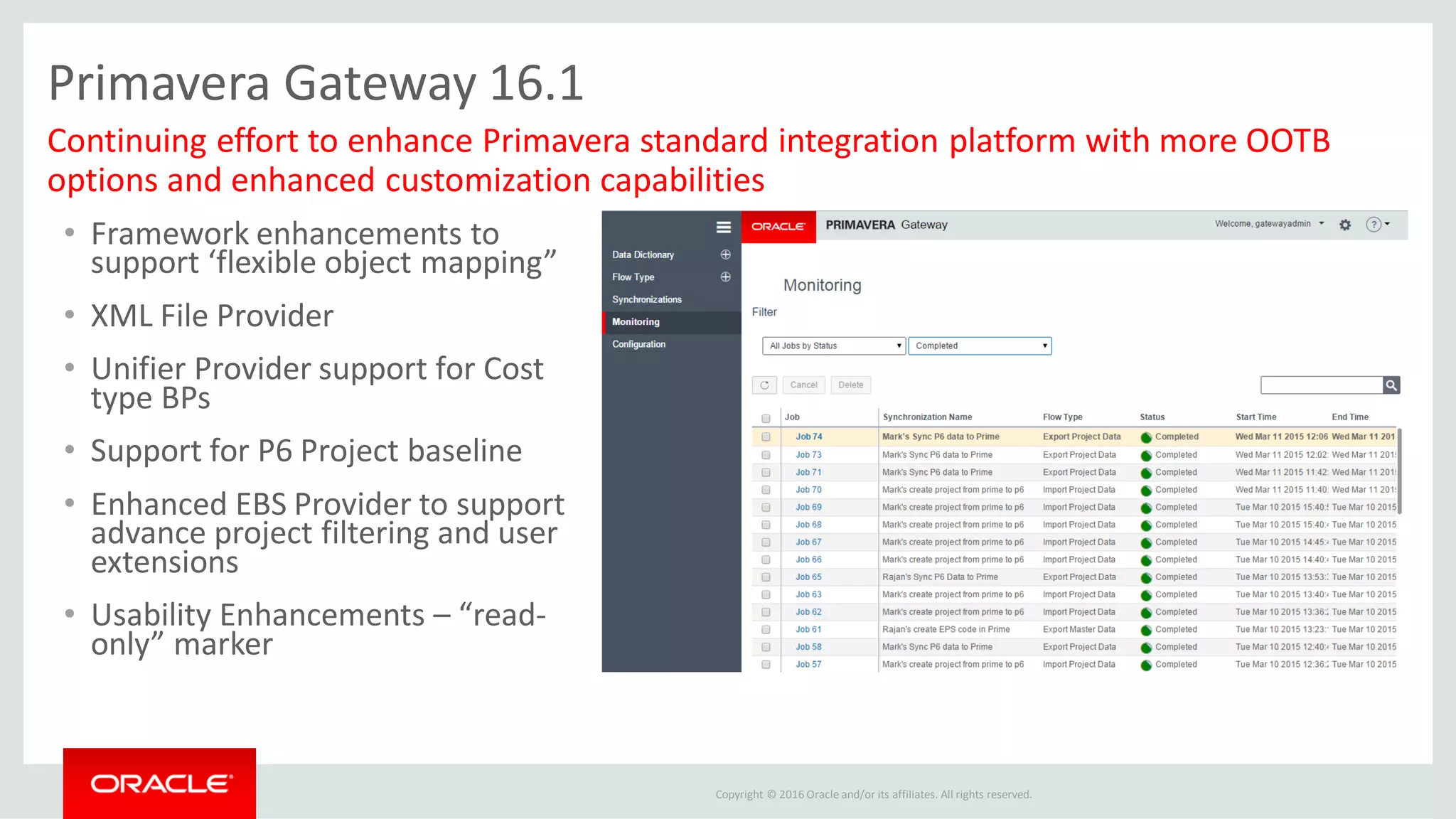

Primavera Gateway 16.1
• Framework enhancements to
support ‘flexible object mapping”
• XML File Provider
• Unifier Provider support for Cost
type BPs
• Support for P6 Project baseline
• Enhanced EBS Provider to support
advance project filtering and user
extensions
• Usability Enhancements – “read-
only” marker
Continuing effort to enhance Primavera standard integration platform with more OOTB
options and enhanced customization capabilities
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.

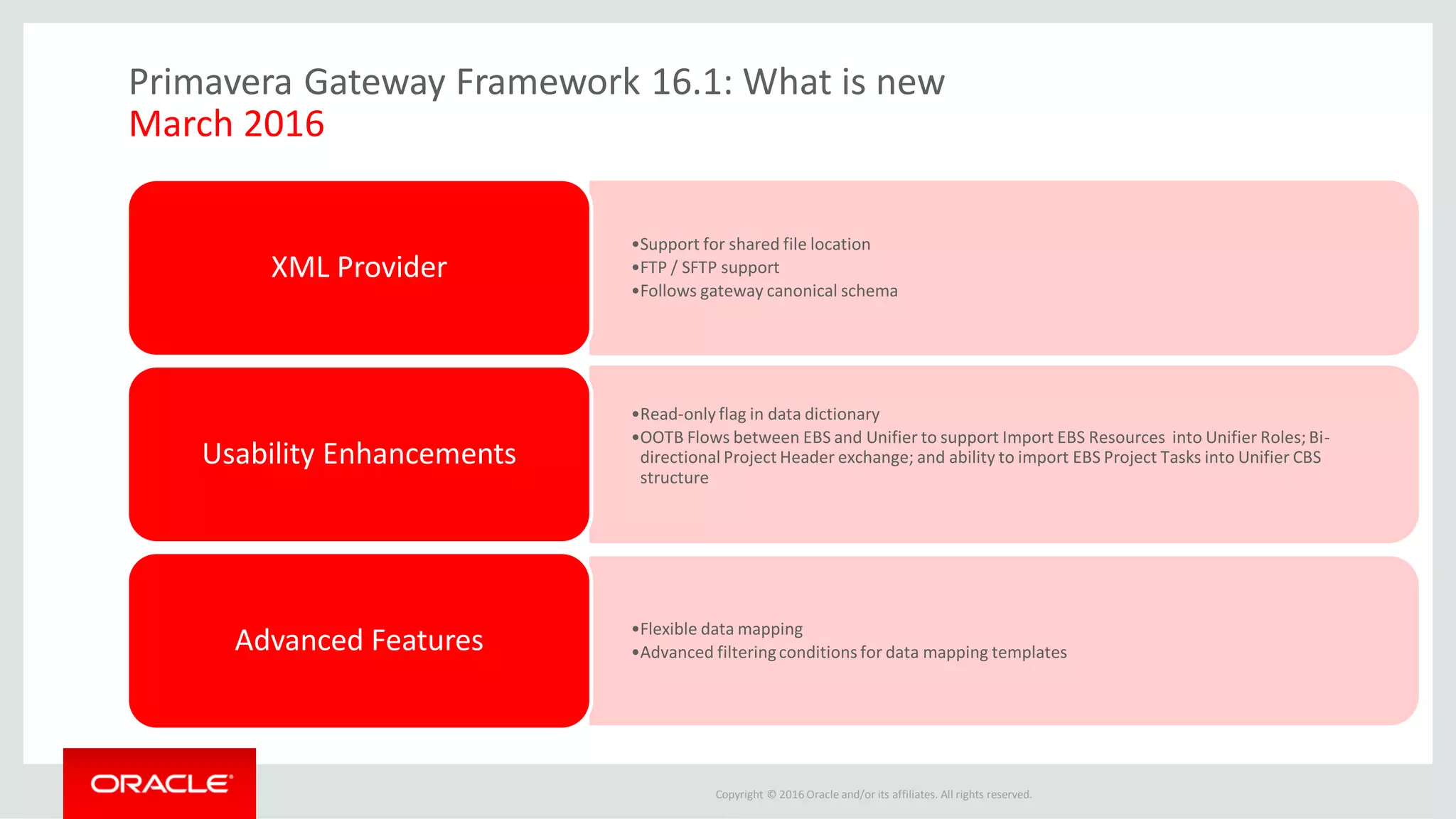

Primavera Gateway Framework 16.1: What is new
March 2016
•Support for shared file location
•FTP / SFTP support
•Follows gateway canonical schema
XML Provider
•Read-only flag in data dictionary
•OOTB Flows between EBS and Unifier to support Import EBS Resources into Unifier Roles; Bi-
directional Project Header exchange; and ability to import EBS Project Tasks into Unifier CBS
structure
Usability Enhancements
•Flexible data mapping
•Advanced filteringconditions for data mapping templatesAdvanced Features
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.

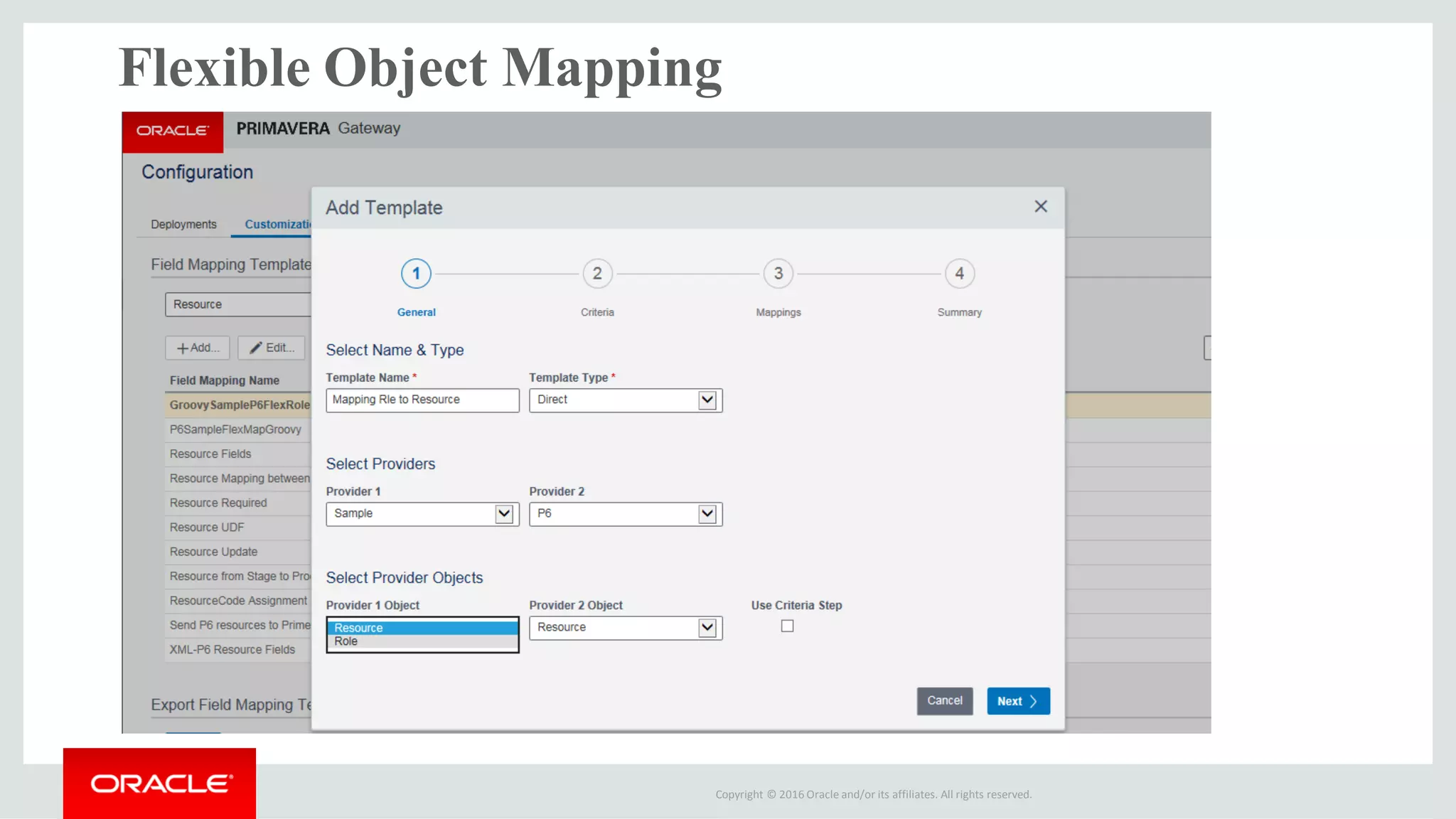

Flexible Object Mapping
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.

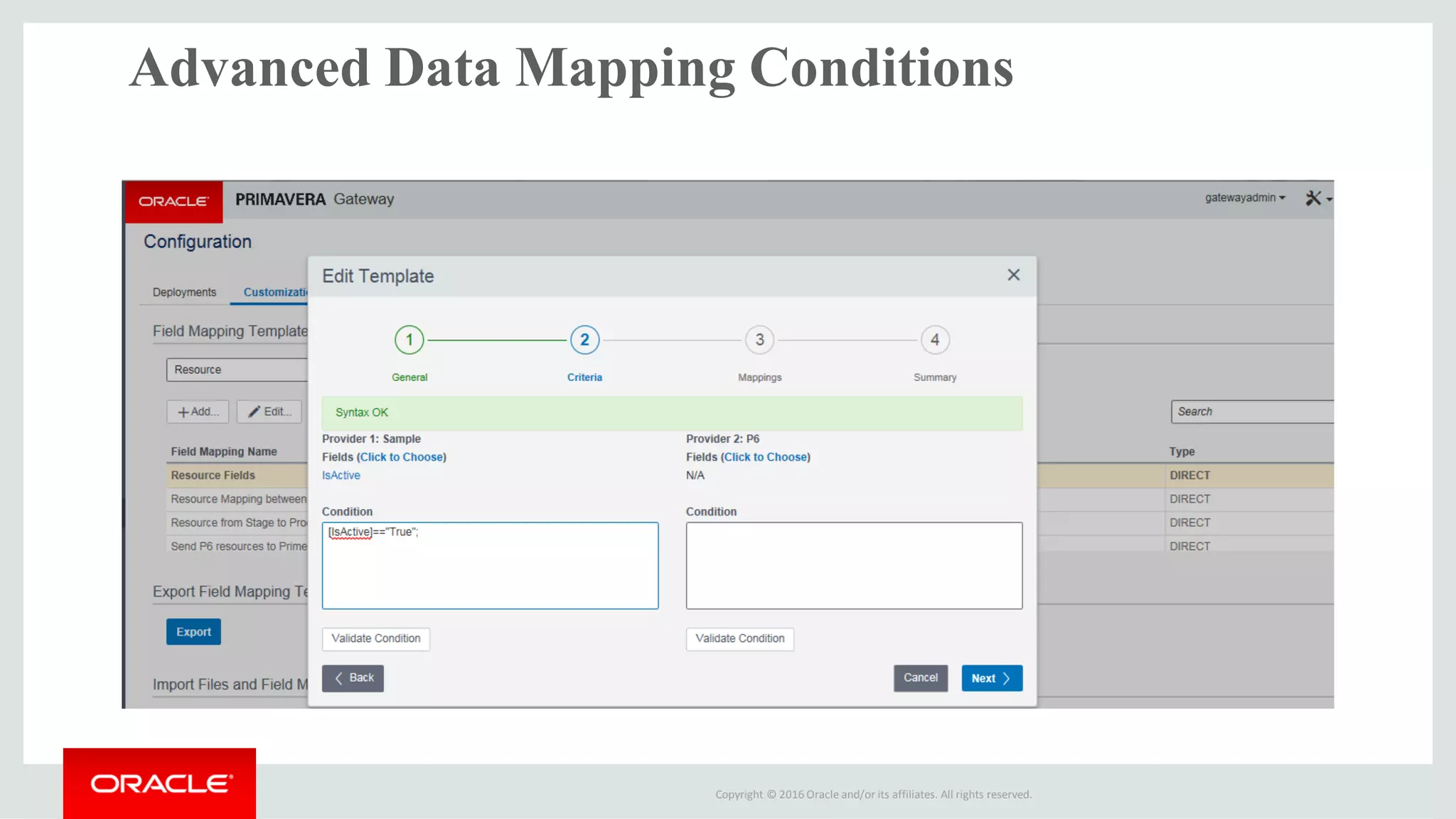

Advanced Data Mapping Conditions
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.

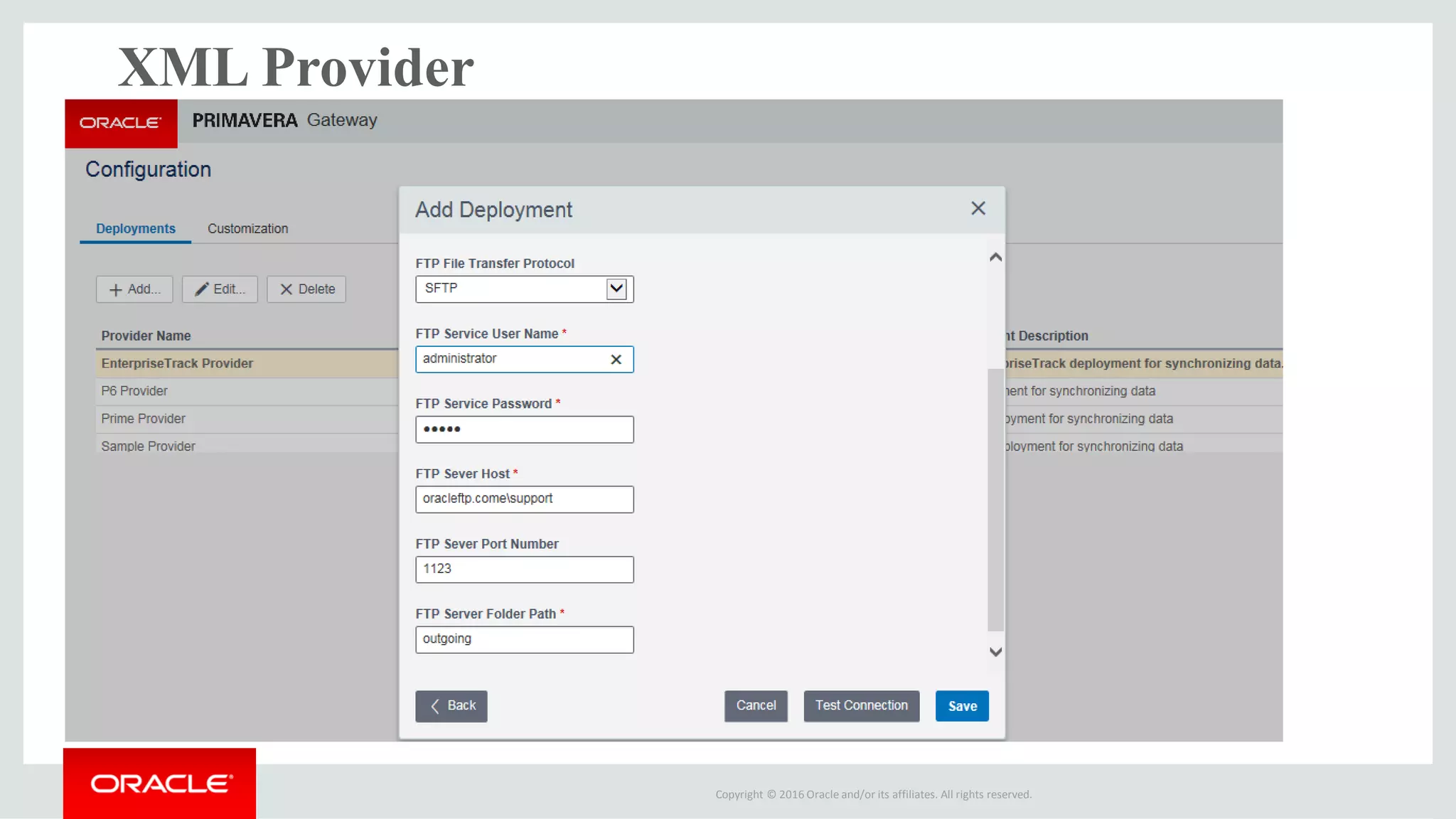

XML Provider
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.

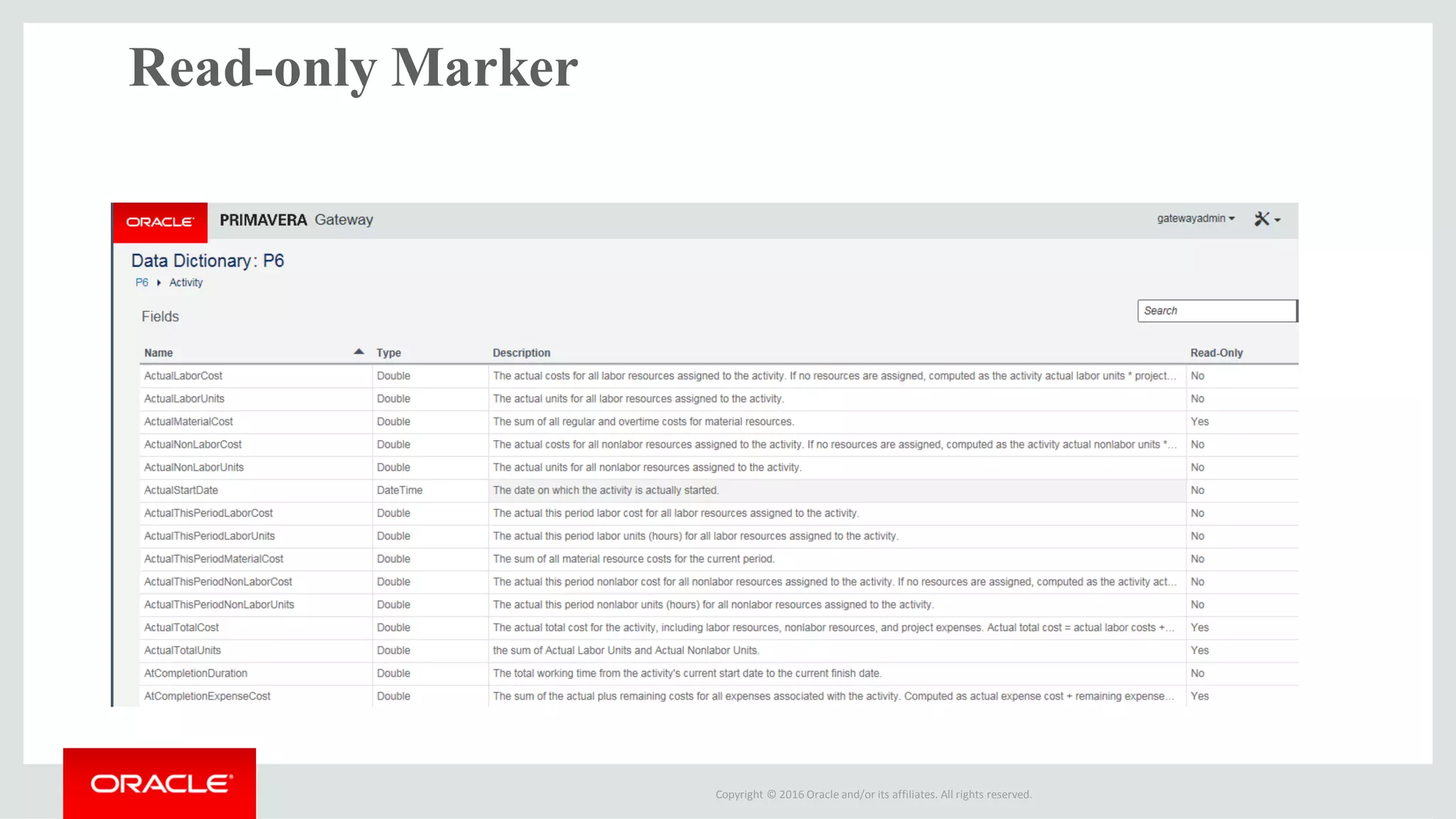

Read-only Marker
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.

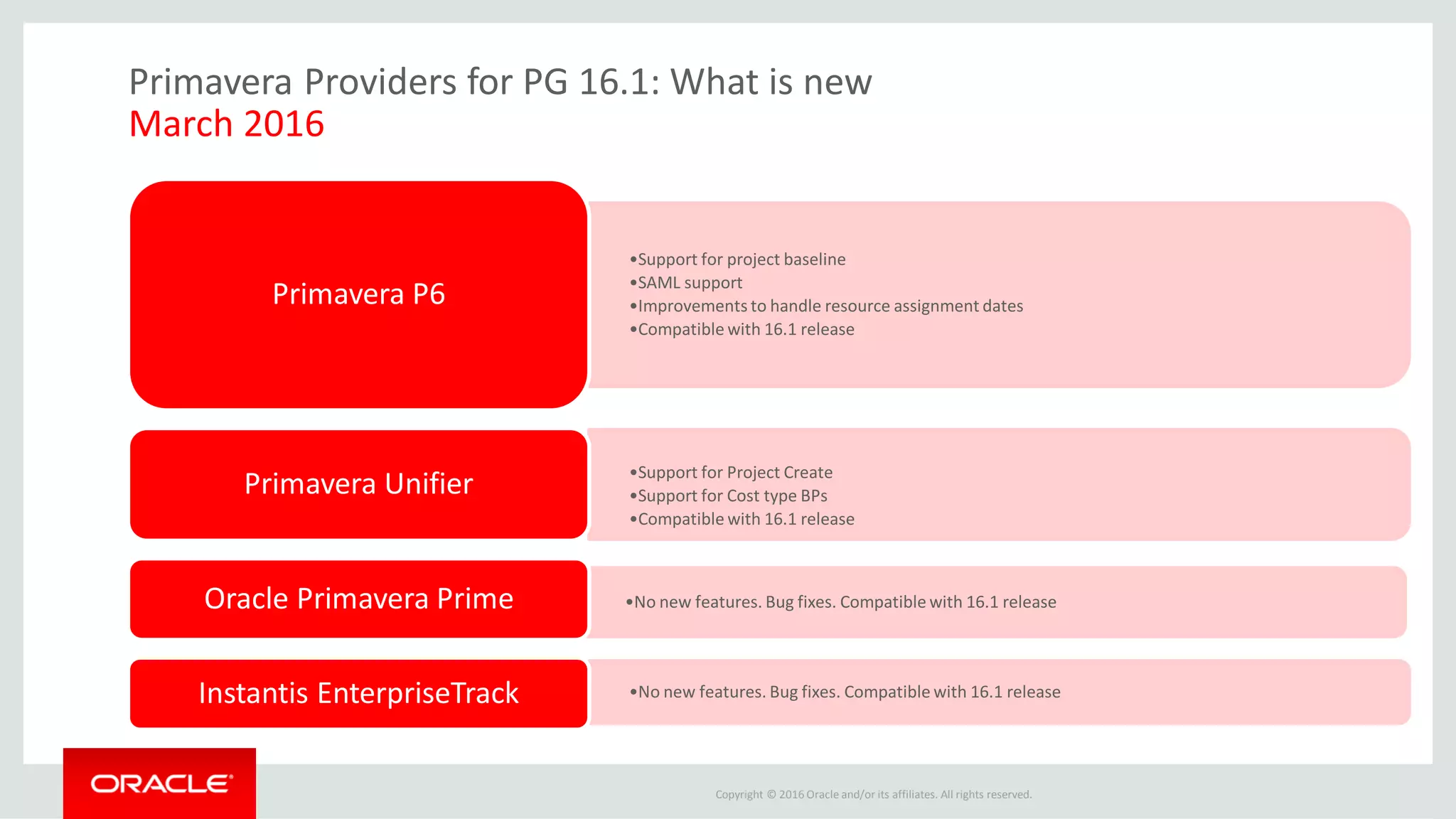

Primavera Providers for PG 16.1: What is new
March 2016
•Support for project baseline
•SAML support
•Improvements to handle resource assignment dates
•Compatible with 16.1 release
Primavera P6
•Support for Project Create
•Support for Cost type BPs
•Compatible with 16.1 release
Primavera Unifier
•No new features. Bug fixes. Compatible with 16.1 releaseOracle Primavera Prime
•No new features. Bug fixes. Compatible with 16.1 releaseInstantis EnterpriseTrack
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.

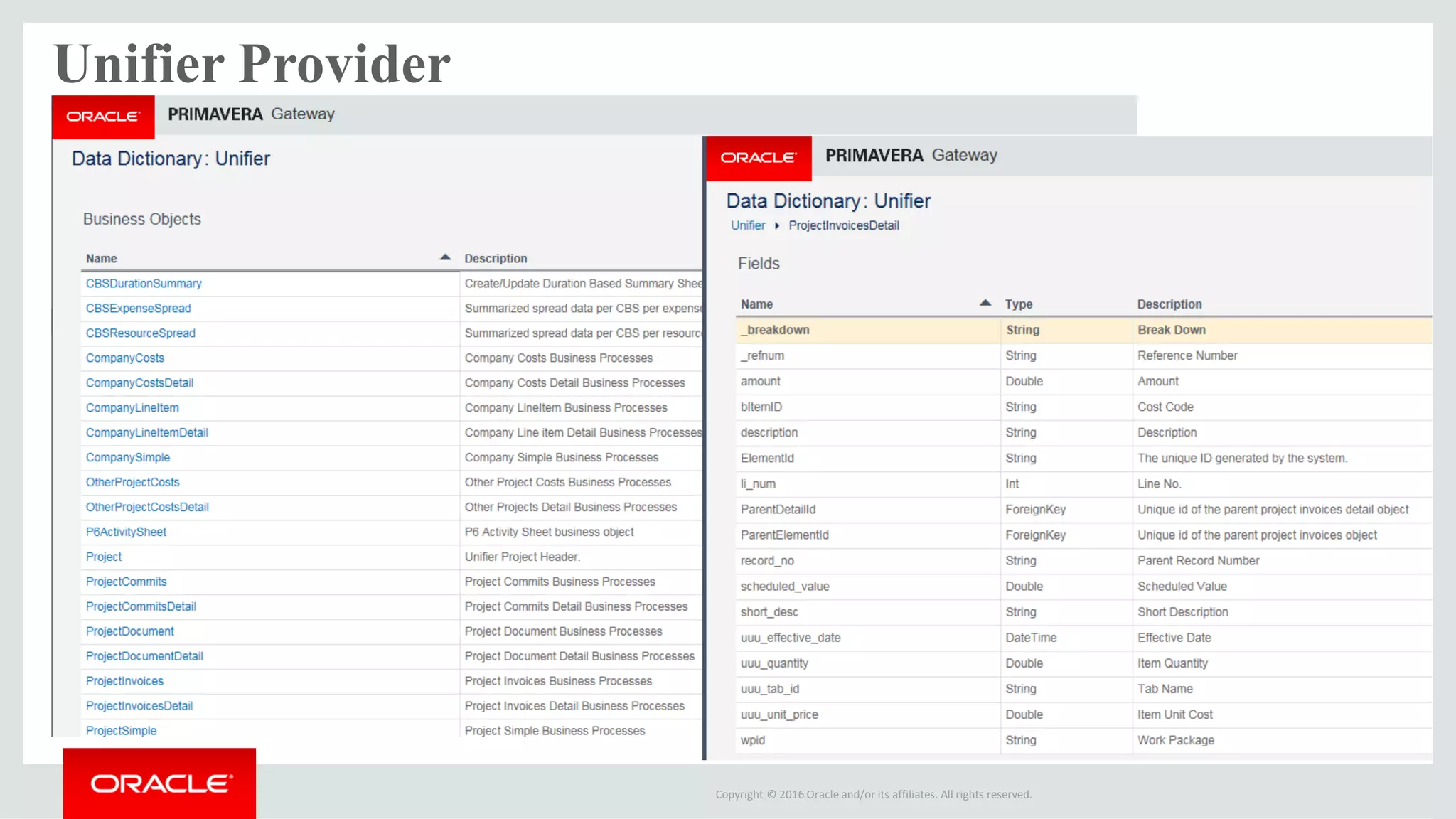

Unifier Provider
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.

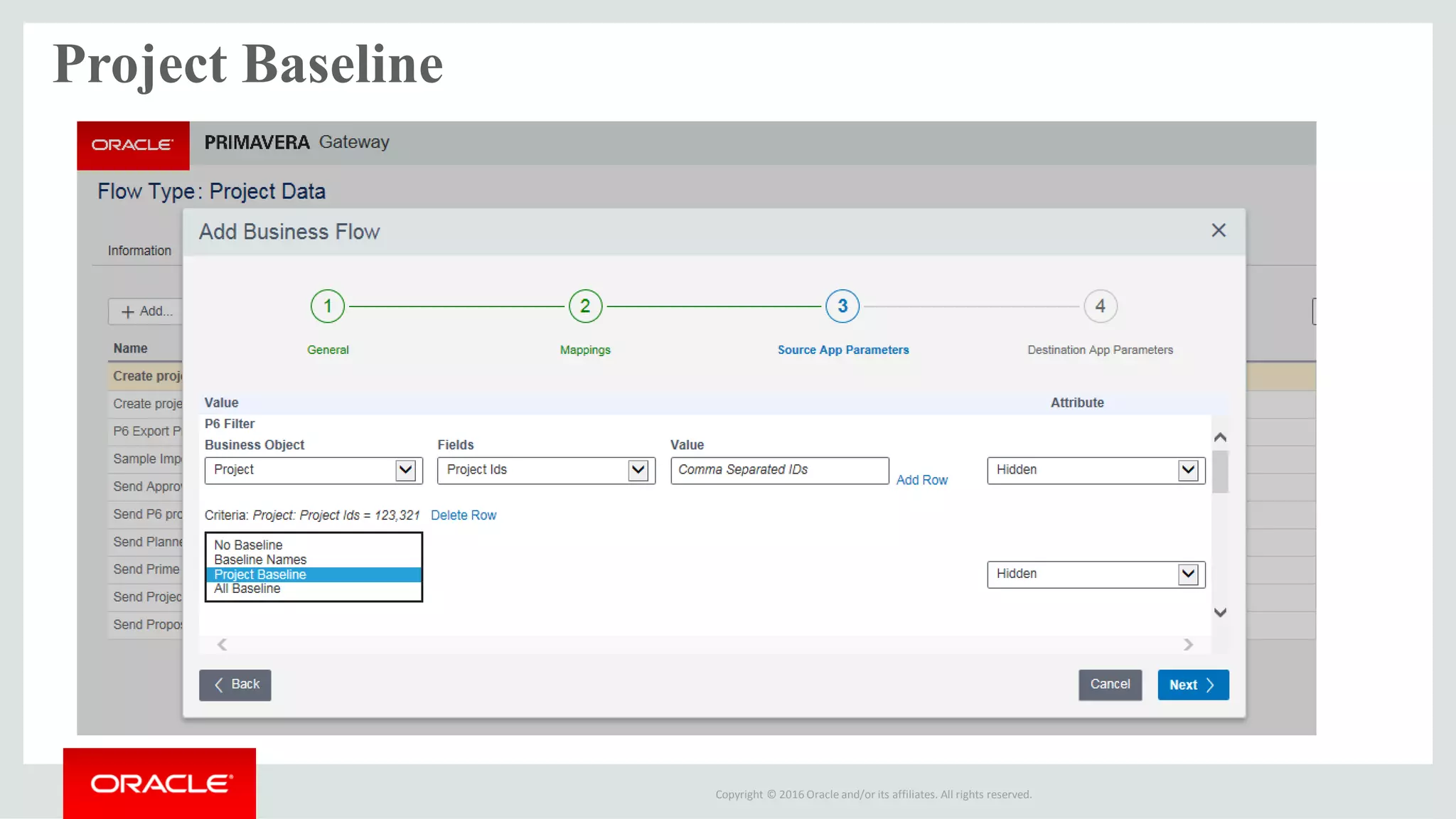

Project Baseline
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.

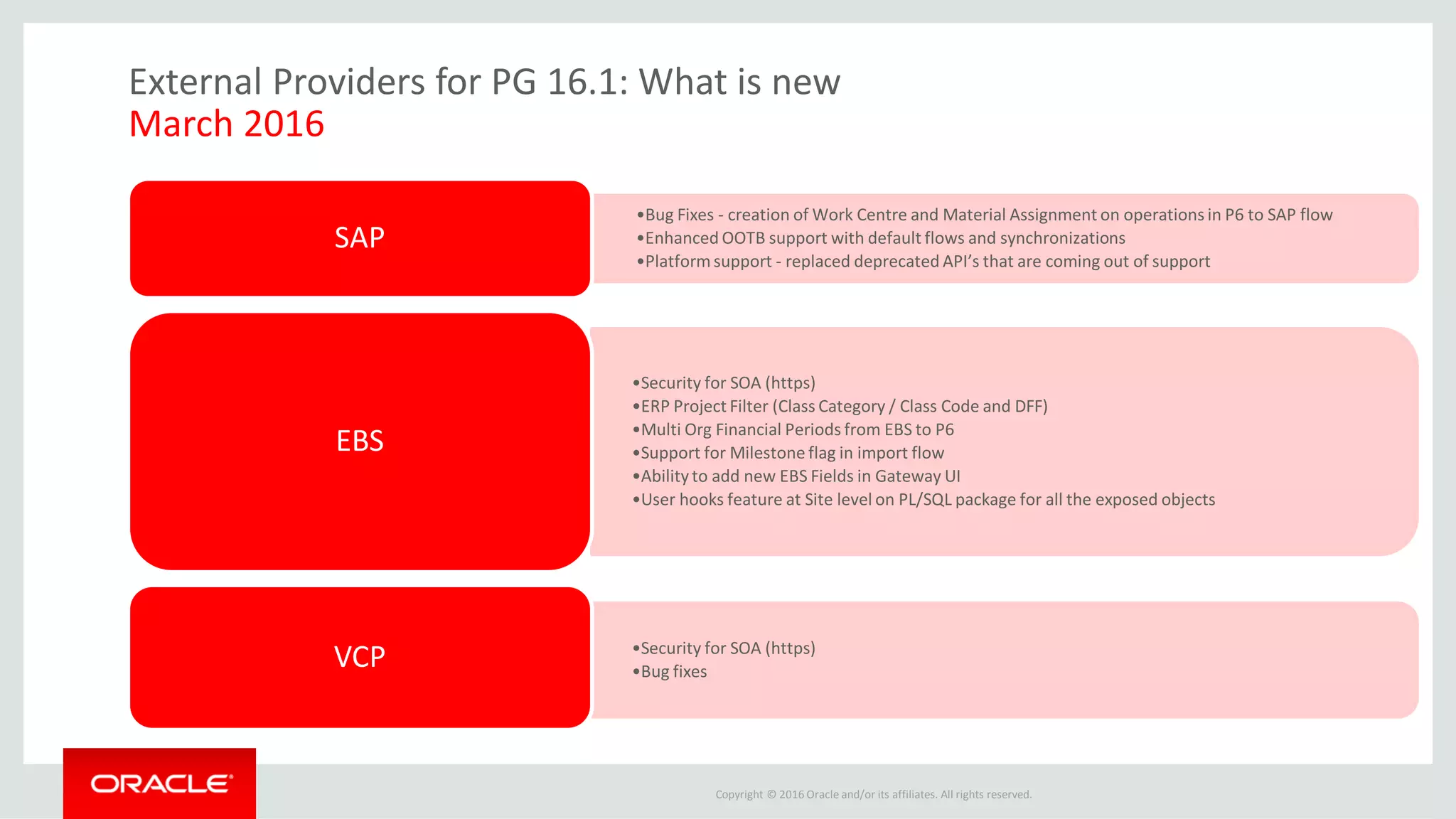

External Providers for PG 16.1: What is new
March 2016
•Bug Fixes - creation of Work Centre and Material Assignment on operations in P6 to SAP flow
•Enhanced OOTB support with default flows and synchronizations
•Platformsupport - replaced deprecated API’s that are coming out of support
SAP
•Security for SOA (https)
•ERP Project Filter (Class Category / Class Code and DFF)
•Multi Org Financial Periods from EBS to P6
•Support for Milestone flag in import flow
•Abilityto add new EBS Fields in Gateway UI
•User hooks feature at Site level on PL/SQL package for all the exposed objects
EBS
•Security for SOA (https)
•Bug fixes
VCP
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.
OOTB Integrations
Primavera Gateway 16.1
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.

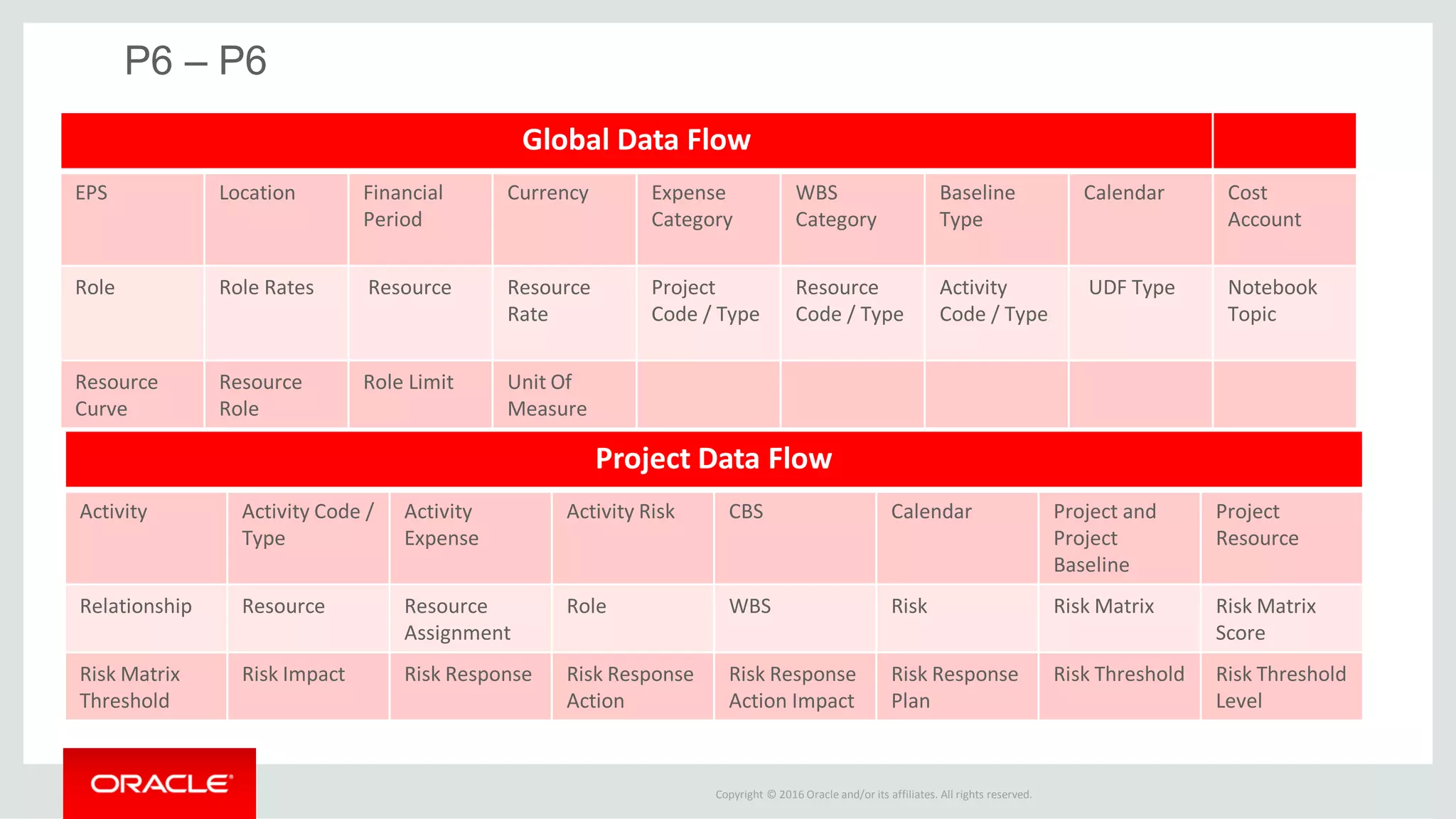

P6 – P6
Global Data Flow
EPS Location Financial
Period
Currency Expense
Category
WBS
Category
Baseline
Type
Calendar Cost
Account
Role Role Rates Resource Resource
Rate
Project
Code / Type
Resource
Code / Type
Activity
Code / Type
UDF Type Notebook
Topic
Resource
Curve
Resource
Role
Role Limit Unit Of
Measure
Project Data Flow
Activity Activity Code /
Type
Activity
Expense
Activity Risk CBS Calendar Project and
Project
Baseline
Project
Resource
Relationship Resource Resource
Assignment
Role WBS Risk Risk Matrix Risk Matrix
Score
Risk Matrix
Threshold
Risk Impact Risk Response Risk Response
Action
Risk Response
Action Impact
Risk Response
Plan
Risk Threshold Risk Threshold
Level
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.

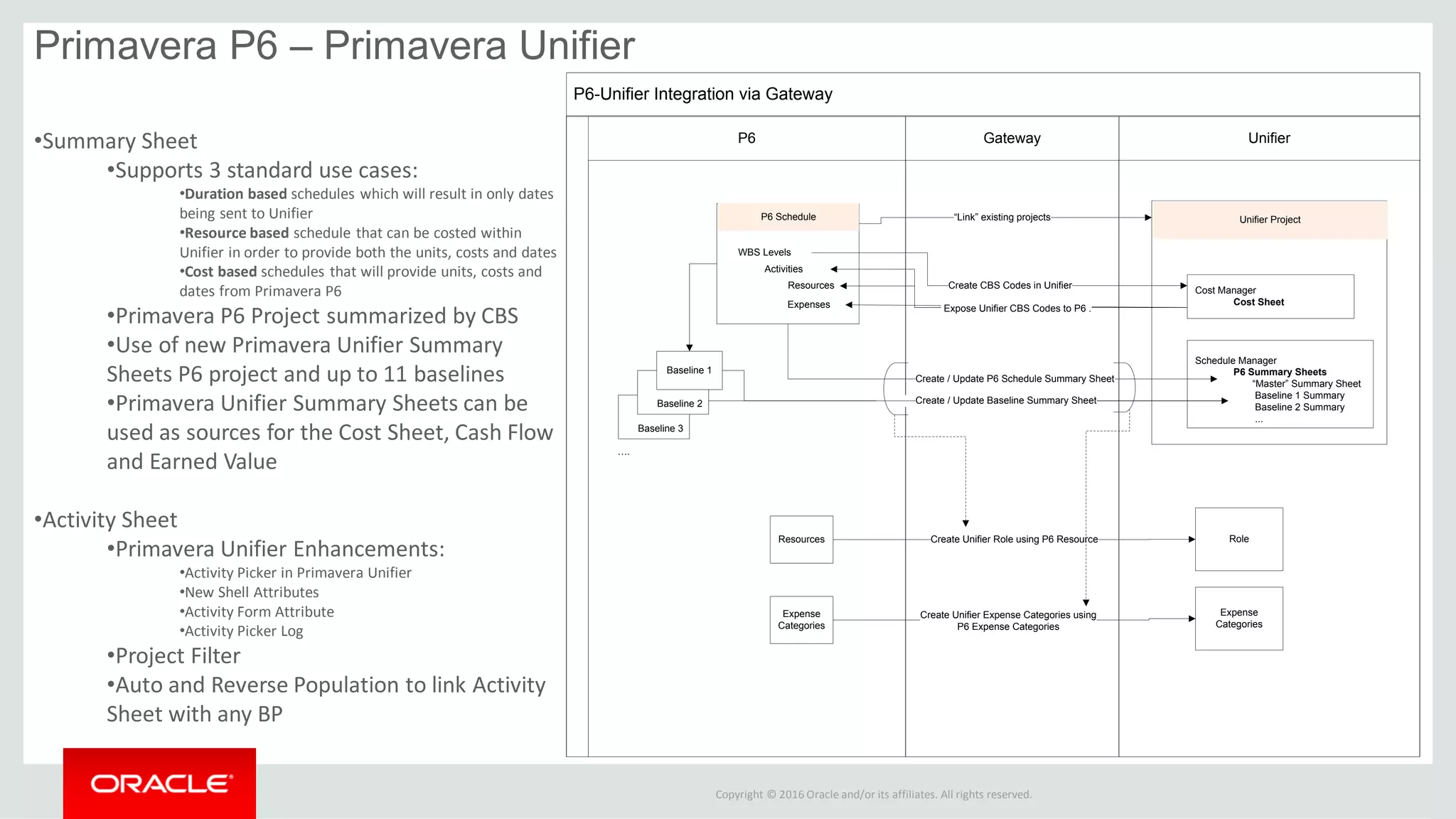

P6-Unifier Integration via Gateway
P6
Baseline 3
UnifierGateway
Baseline 2
Baseline 1
….
“Link” existing projectsP6 Schedule Unifier Project
Cost Manager
Cost Sheet
Schedule Manager
P6 Summary Sheets
“Master” Summary Sheet
Baseline 1 Summary
Baseline 2 Summary
...
Create CBS Codes in Unifier
WBS Levels
Activities
Resources
.
Create / Update P6 Schedule Summary Sheet
.Create / Update Baseline Summary Sheet
Expenses Expose Unifier CBS Codes to P6 .
Create Unifier Role using P6 Resource
Create Unifier Expense Categories using
P6 Expense Categories
Resources
Expense
Categories
Role
Expense
Categories
Primavera P6 – Primavera Unifier
•Summary Sheet
•Supports 3 standard use cases:
•Duration based schedules which will result in only dates
being sent to Unifier
•Resource based schedule that can be costed within
Unifier in order to provide both the units, costs and dates
•Cost based schedules that will provide units, costs and
dates from Primavera P6
•Primavera P6 Project summarized by CBS
•Use of new Primavera Unifier Summary
Sheets P6 project and up to 11 baselines
•Primavera Unifier Summary Sheets can be
used as sources for the Cost Sheet, Cash Flow
and Earned Value
•Activity Sheet
•Primavera Unifier Enhancements:
•Activity Picker in Primavera Unifier
•New Shell Attributes
•Activity Form Attribute
•Activity Picker Log
•Project Filter
•Auto and Reverse Population to link Activity
Sheet with any BP
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.

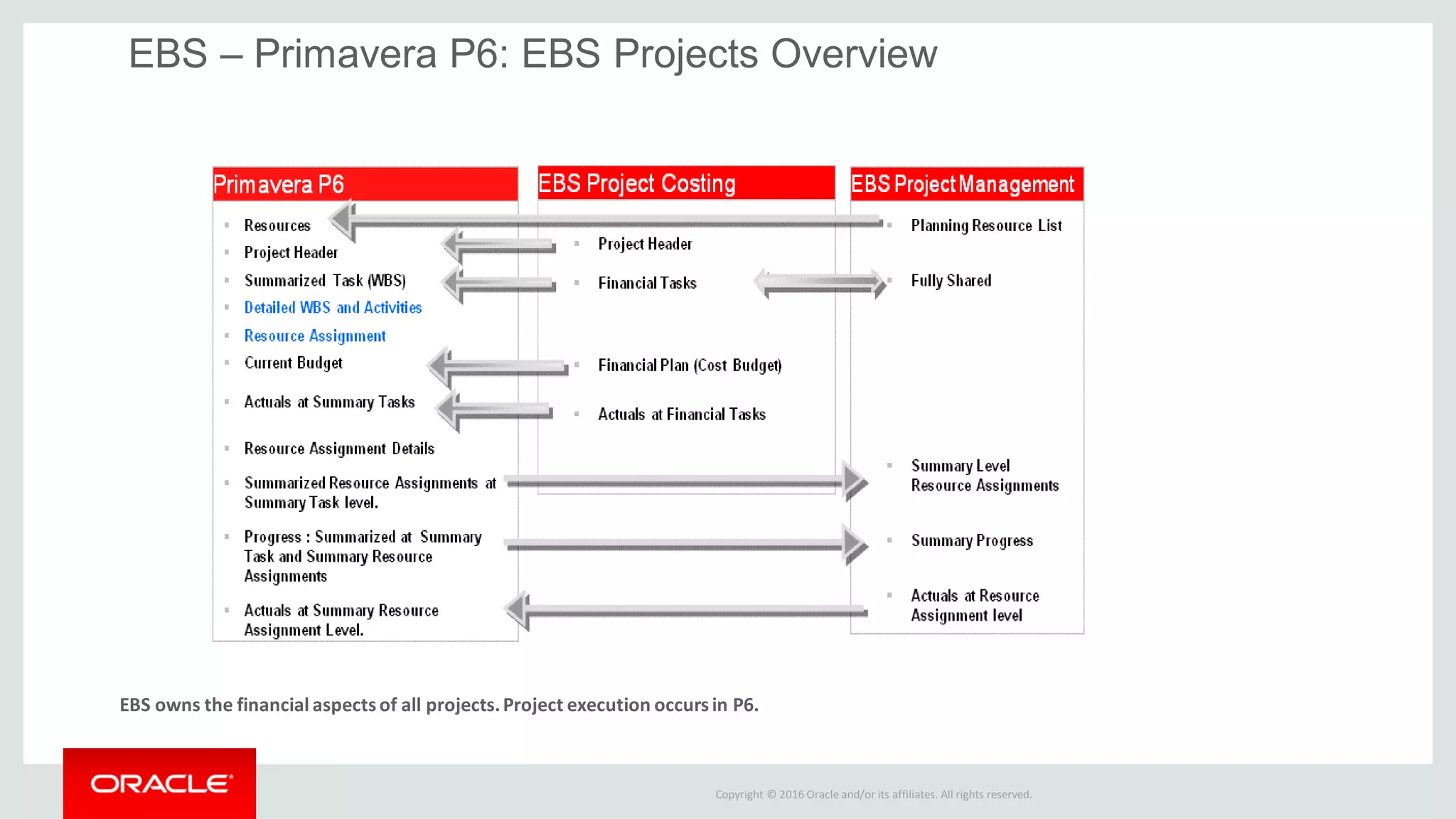

EBS – Primavera P6: EBS Projects Overview
EBS owns the financial aspectsof all projects.Project execution occursin P6.
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.

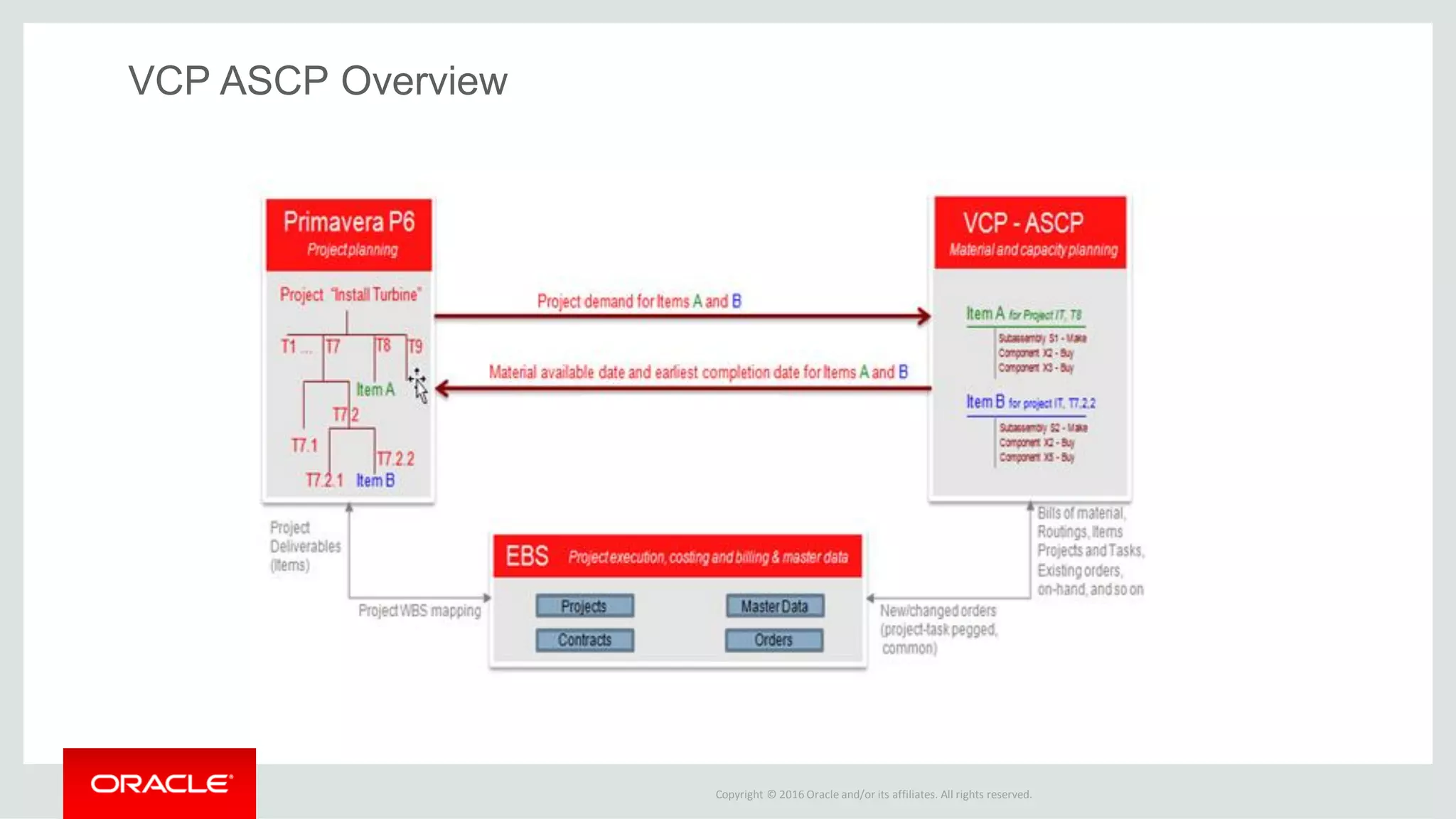

VCP ASCP Overview
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.
Resource Master Data
Project
WBS
Budgets
Activities/WorkOrders
Resource Assignments
Actual Hours
Material Components
Actual Costs
Resource Master Data
Project
WBS
Budgets
Activities/Operations
Resource Assignments
Actual Hours
Activities/ResourceAssignments
Actual Costs

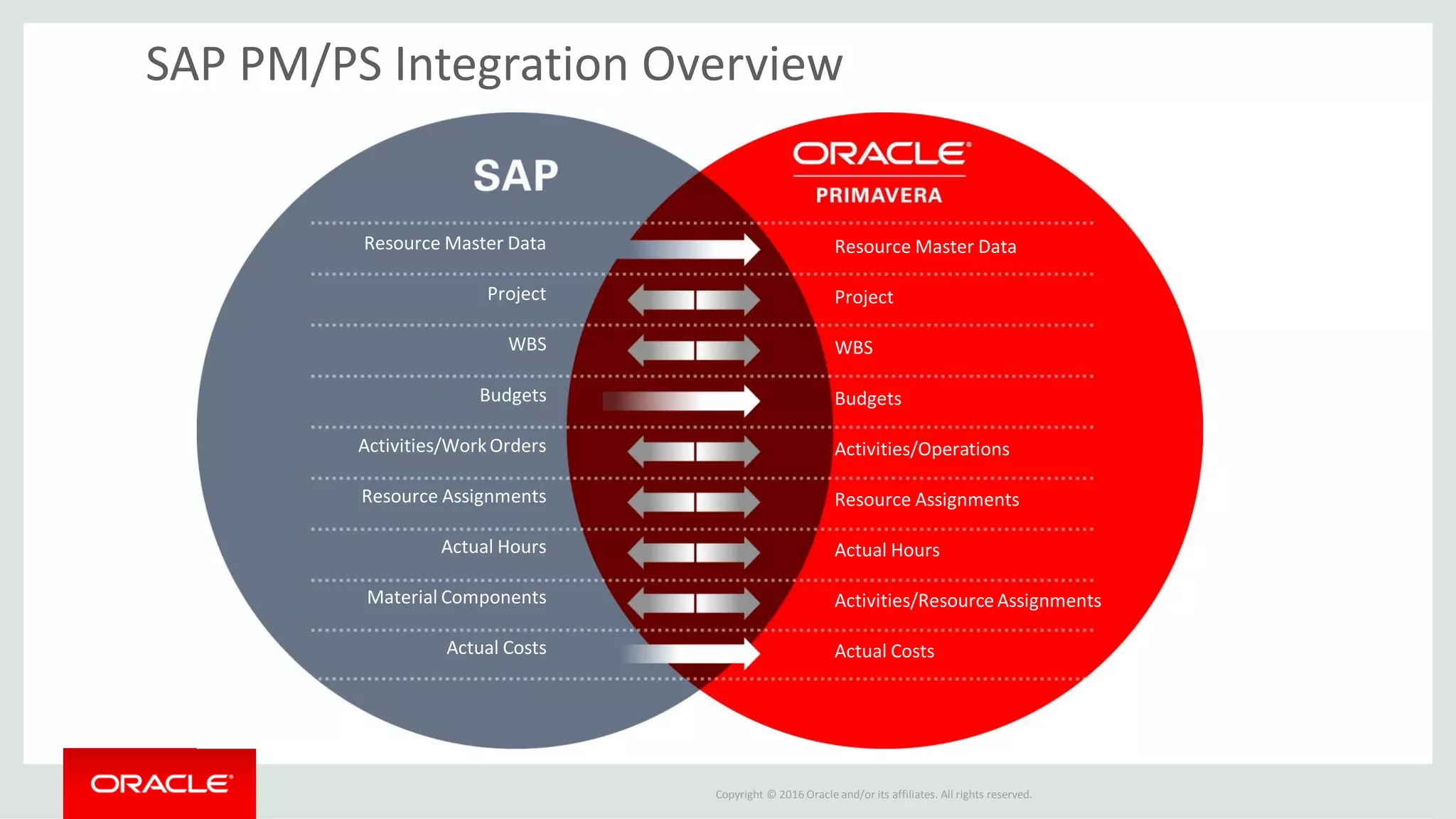

SAP PM/PS Integration Overview
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.

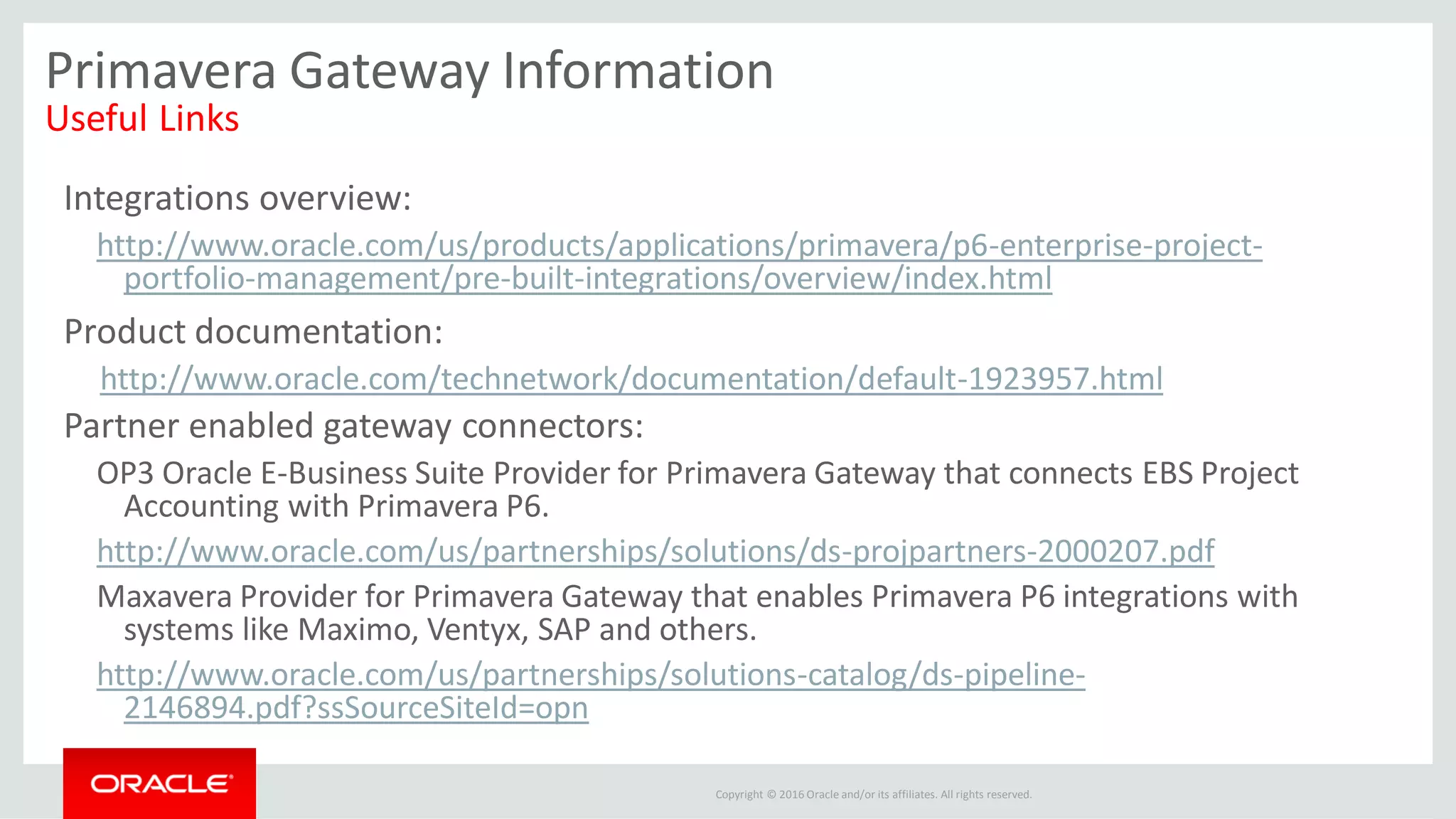

Primavera Gateway Information
Useful Links
Integrations overview:
http://www.oracle.com/us/products/applications/primavera/p6-enterprise-project-
portfolio-management/pre-built-integrations/overview/index.html
Product documentation:
http://www.oracle.com/technetwork/documentation/default-1923957.html
Partner enabled gateway connectors:
OP3 Oracle E-Business Suite Provider for Primavera Gateway that connects EBS Project
Accounting with Primavera P6.
http://www.oracle.com/us/partnerships/solutions/ds-projpartners-2000207.pdf
Maxavera Provider for Primavera Gateway that enables Primavera P6 integrations with
systems like Maximo, Ventyx, SAP and others.
http://www.oracle.com/us/partnerships/solutions-catalog/ds-pipeline-
2146894.pdf?ssSourceSiteId=opn
Copyright © 2016, Oracle and/or its affiliates. All rights reserved.28
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.
Safe Harbor Statement
The preceding is intended to outline our general product direction. It is intended for
information purposes only, and may not be incorporated into any contract. It is not a
commitment to deliver any material, code, or functionality, and should not be relied upon
in making purchasing decisions. The development, release, and timing of any features or
functionality described for Oracle’s products remains at the sole discretion of Oracle.
29
Copyright © 2016 Oracle and/or its affiliates. All rights reserved.
What's New in Primavera Gateway 16.1

What's New in Primavera Gateway 16.1

  • 2.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. Primavera Gateway 16 Release 1 – March 2016 John Pikovskiy Director Oracle Primavera Product Strategy
  • 3.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. Safe Harbor Statement The following is intended to outline our general product direction. It is intended for information purposes only, and may not be incorporated into any contract. It is not a commitment to deliver any material, code, or functionality, and should not be relied upon in making purchasing decisions. The development, release, and timing of any features or functionality described for Oracle’s products remains at the sole discretion of Oracle. 3
  • 4.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. Agenda Overview of Oracle’s Primavera Gateway Primavera Gateway 16.1 new features Inventory of OOTB integrations 1 2 3 4
  • 5.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. Overview Primavera Gateway
  • 6.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. Primavera Gateway • Pre-packaged integration connections for a variety of Primavera internal and 3rd Party applications • Java application with no dependency on third party middleware provides extensible integration solution • Combine financial management and asset management information with project, portfolio and resource management • Simple integration framework allows customers and partners to quickly develop and adopt Primavera Gateway for integration Standard data integration solution to streamline EPPM planning and execution process
  • 7.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. Pre-built Primavera Gateway Partner’s , Competitors Custom WS / API SOA , ICS, Non-Oracle , Legacy Integration Options
  • 8.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. Oracle’s Primavera Integration Strategy Integrating Primavera internally and with 3rd Party Products • Complete – Spans across all asset intensive industries – Supports all project driven use cases – ERP agnostic design • Extensible – Adjustable to customer specific needs and requirements • Supported – All Oracle Solution – On-going development to enhance Primavera Gateway and stay current with platforms and current versions of integrated products
  • 9.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. Integration Strategy Architectural Overview Primavera Gateway NonPrimaveraApplications PrimaveraEPPM Integration Broker Graphical User Interface Configuration; Role-based security; Ad-hoc synchronizations; Monitoring SAP Provider Unifier Provider EBS Provider VCP Provider P6 Provider PublicAPI/CustomAdapter IntegrationSynchServices Compare Industry-Specific Flows and Data Maps Routine Maintenance; Shutdown and turnaround; Capital Project Logging Scheduling Audit Customizations Sample Provider ETrack Provider “Prime” Provider Partner Providers File (XML) Provider
  • 10.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. Today Primavera Gateway 16.1
  • 11.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. Primavera Gateway 16.1 • Framework enhancements to support ‘flexible object mapping” • XML File Provider • Unifier Provider support for Cost type BPs • Support for P6 Project baseline • Enhanced EBS Provider to support advance project filtering and user extensions • Usability Enhancements – “read- only” marker Continuing effort to enhance Primavera standard integration platform with more OOTB options and enhanced customization capabilities
  • 12.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. Primavera Gateway Framework 16.1: What is new March 2016 •Support for shared file location •FTP / SFTP support •Follows gateway canonical schema XML Provider •Read-only flag in data dictionary •OOTB Flows between EBS and Unifier to support Import EBS Resources into Unifier Roles; Bi- directional Project Header exchange; and ability to import EBS Project Tasks into Unifier CBS structure Usability Enhancements •Flexible data mapping •Advanced filteringconditions for data mapping templatesAdvanced Features
  • 13.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. Flexible Object Mapping
  • 14.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. Advanced Data Mapping Conditions
  • 15.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. XML Provider
  • 16.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. Read-only Marker
  • 17.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. Primavera Providers for PG 16.1: What is new March 2016 •Support for project baseline •SAML support •Improvements to handle resource assignment dates •Compatible with 16.1 release Primavera P6 •Support for Project Create •Support for Cost type BPs •Compatible with 16.1 release Primavera Unifier •No new features. Bug fixes. Compatible with 16.1 releaseOracle Primavera Prime •No new features. Bug fixes. Compatible with 16.1 releaseInstantis EnterpriseTrack
  • 18.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. Unifier Provider
  • 19.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. Project Baseline
  • 20.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. External Providers for PG 16.1: What is new March 2016 •Bug Fixes - creation of Work Centre and Material Assignment on operations in P6 to SAP flow •Enhanced OOTB support with default flows and synchronizations •Platformsupport - replaced deprecated API’s that are coming out of support SAP •Security for SOA (https) •ERP Project Filter (Class Category / Class Code and DFF) •Multi Org Financial Periods from EBS to P6 •Support for Milestone flag in import flow •Abilityto add new EBS Fields in Gateway UI •User hooks feature at Site level on PL/SQL package for all the exposed objects EBS •Security for SOA (https) •Bug fixes VCP
  • 21.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. OOTB Integrations Primavera Gateway 16.1
  • 22.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. P6 – P6 Global Data Flow EPS Location Financial Period Currency Expense Category WBS Category Baseline Type Calendar Cost Account Role Role Rates Resource Resource Rate Project Code / Type Resource Code / Type Activity Code / Type UDF Type Notebook Topic Resource Curve Resource Role Role Limit Unit Of Measure Project Data Flow Activity Activity Code / Type Activity Expense Activity Risk CBS Calendar Project and Project Baseline Project Resource Relationship Resource Resource Assignment Role WBS Risk Risk Matrix Risk Matrix Score Risk Matrix Threshold Risk Impact Risk Response Risk Response Action Risk Response Action Impact Risk Response Plan Risk Threshold Risk Threshold Level
  • 23.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. P6-Unifier Integration via Gateway P6 Baseline 3 UnifierGateway Baseline 2 Baseline 1 …. “Link” existing projectsP6 Schedule Unifier Project Cost Manager Cost Sheet Schedule Manager P6 Summary Sheets “Master” Summary Sheet Baseline 1 Summary Baseline 2 Summary ... Create CBS Codes in Unifier WBS Levels Activities Resources . Create / Update P6 Schedule Summary Sheet .Create / Update Baseline Summary Sheet Expenses Expose Unifier CBS Codes to P6 . Create Unifier Role using P6 Resource Create Unifier Expense Categories using P6 Expense Categories Resources Expense Categories Role Expense Categories Primavera P6 – Primavera Unifier •Summary Sheet •Supports 3 standard use cases: •Duration based schedules which will result in only dates being sent to Unifier •Resource based schedule that can be costed within Unifier in order to provide both the units, costs and dates •Cost based schedules that will provide units, costs and dates from Primavera P6 •Primavera P6 Project summarized by CBS •Use of new Primavera Unifier Summary Sheets P6 project and up to 11 baselines •Primavera Unifier Summary Sheets can be used as sources for the Cost Sheet, Cash Flow and Earned Value •Activity Sheet •Primavera Unifier Enhancements: •Activity Picker in Primavera Unifier •New Shell Attributes •Activity Form Attribute •Activity Picker Log •Project Filter •Auto and Reverse Population to link Activity Sheet with any BP
  • 24.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. EBS – Primavera P6: EBS Projects Overview EBS owns the financial aspectsof all projects.Project execution occursin P6.
  • 25.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. VCP ASCP Overview
  • 26.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. Resource Master Data Project WBS Budgets Activities/WorkOrders Resource Assignments Actual Hours Material Components Actual Costs Resource Master Data Project WBS Budgets Activities/Operations Resource Assignments Actual Hours Activities/ResourceAssignments Actual Costs SAP PM/PS Integration Overview
  • 27.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. Primavera Gateway Information Useful Links Integrations overview: http://www.oracle.com/us/products/applications/primavera/p6-enterprise-project- portfolio-management/pre-built-integrations/overview/index.html Product documentation: http://www.oracle.com/technetwork/documentation/default-1923957.html Partner enabled gateway connectors: OP3 Oracle E-Business Suite Provider for Primavera Gateway that connects EBS Project Accounting with Primavera P6. http://www.oracle.com/us/partnerships/solutions/ds-projpartners-2000207.pdf Maxavera Provider for Primavera Gateway that enables Primavera P6 integrations with systems like Maximo, Ventyx, SAP and others. http://www.oracle.com/us/partnerships/solutions-catalog/ds-pipeline- 2146894.pdf?ssSourceSiteId=opn
  • 28.
    Copyright © 2016,Oracle and/or its affiliates. All rights reserved.28
  • 29.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved. Safe Harbor Statement The preceding is intended to outline our general product direction. It is intended for information purposes only, and may not be incorporated into any contract. It is not a commitment to deliver any material, code, or functionality, and should not be relied upon in making purchasing decisions. The development, release, and timing of any features or functionality described for Oracle’s products remains at the sole discretion of Oracle. 29
  • 30.
    Copyright © 2016Oracle and/or its affiliates. All rights reserved.
