Agile/Lean PMO
Andrew Rusling
Agile Coach
@andrewrusling

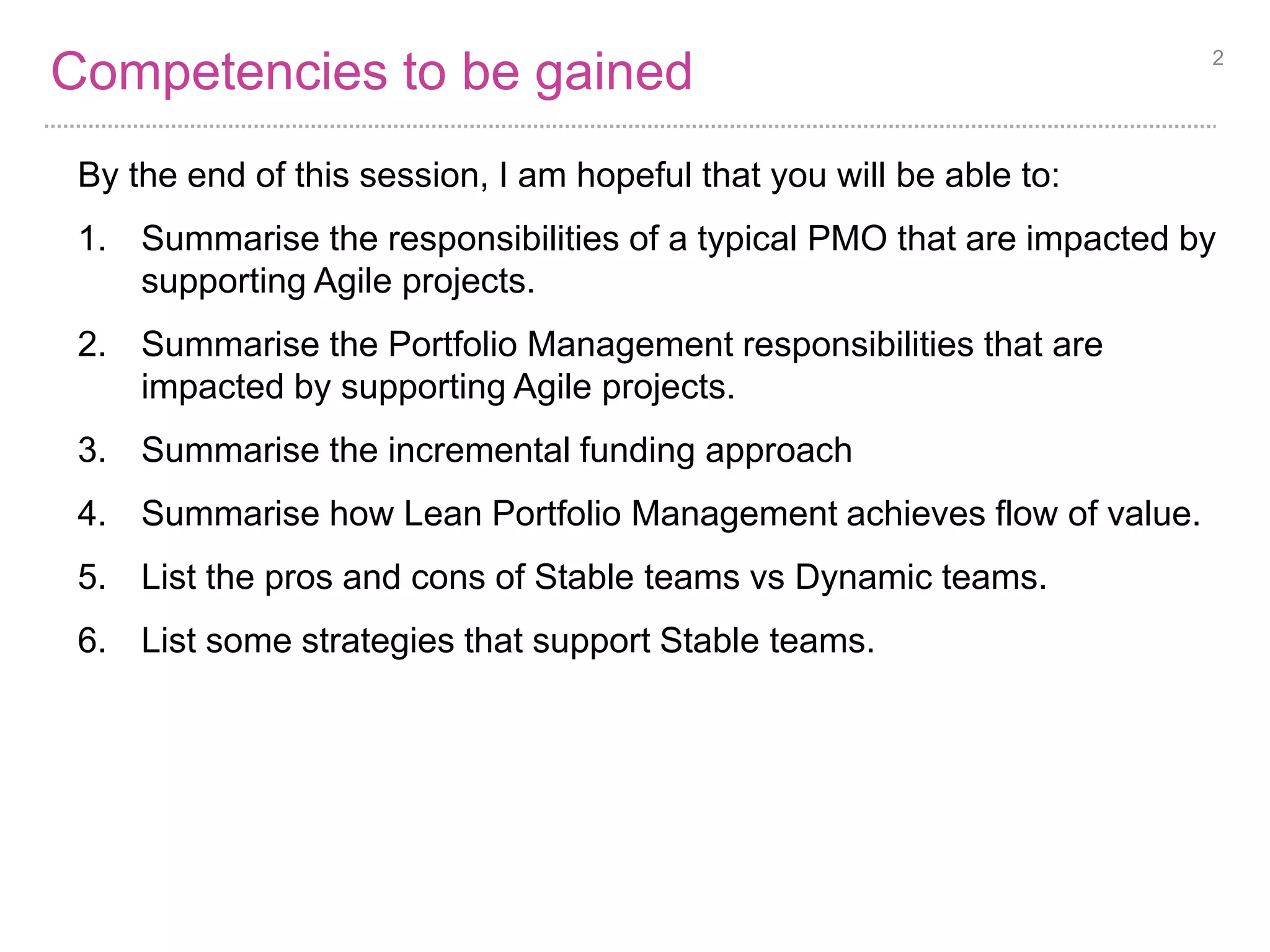

Competencies to be gained
By the end of this session, I am hopeful that you will be able to:
1. Summarise the responsibilities of a typical PMO that are impacted by
supporting Agile projects.
2. Summarise the Portfolio Management responsibilities that are
impacted by supporting Agile projects.
3. Summarise the incremental funding approach
4. Summarise how Lean Portfolio Management achieves flow of value.
5. List the pros and cons of Stable teams vs Dynamic teams.
6. List some strategies that support Stable teams.
2
What is a PMO?

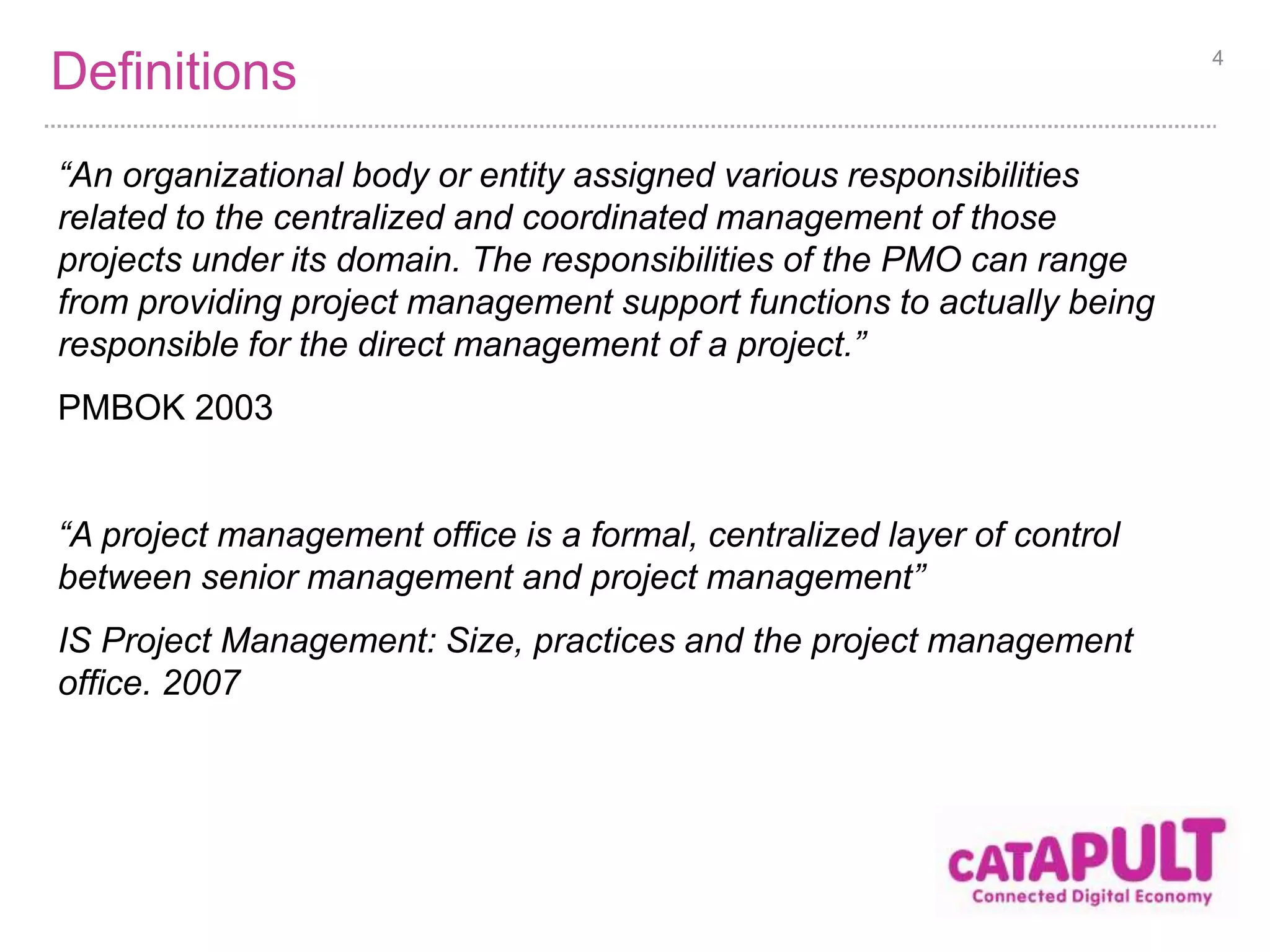

Definitions 4
“An organizational body or entity assigned various responsibilities
related to the centralized and coordinated management of those
projects under its domain. The responsibilities of the PMO can range
from providing project management support functions to actually being
responsible for the direct management of a project.”
PMBOK 2003
“A project management office is a formal, centralized layer of control
between senior management and project management”
IS Project Management: Size, practices and the project management
office. 2007
5

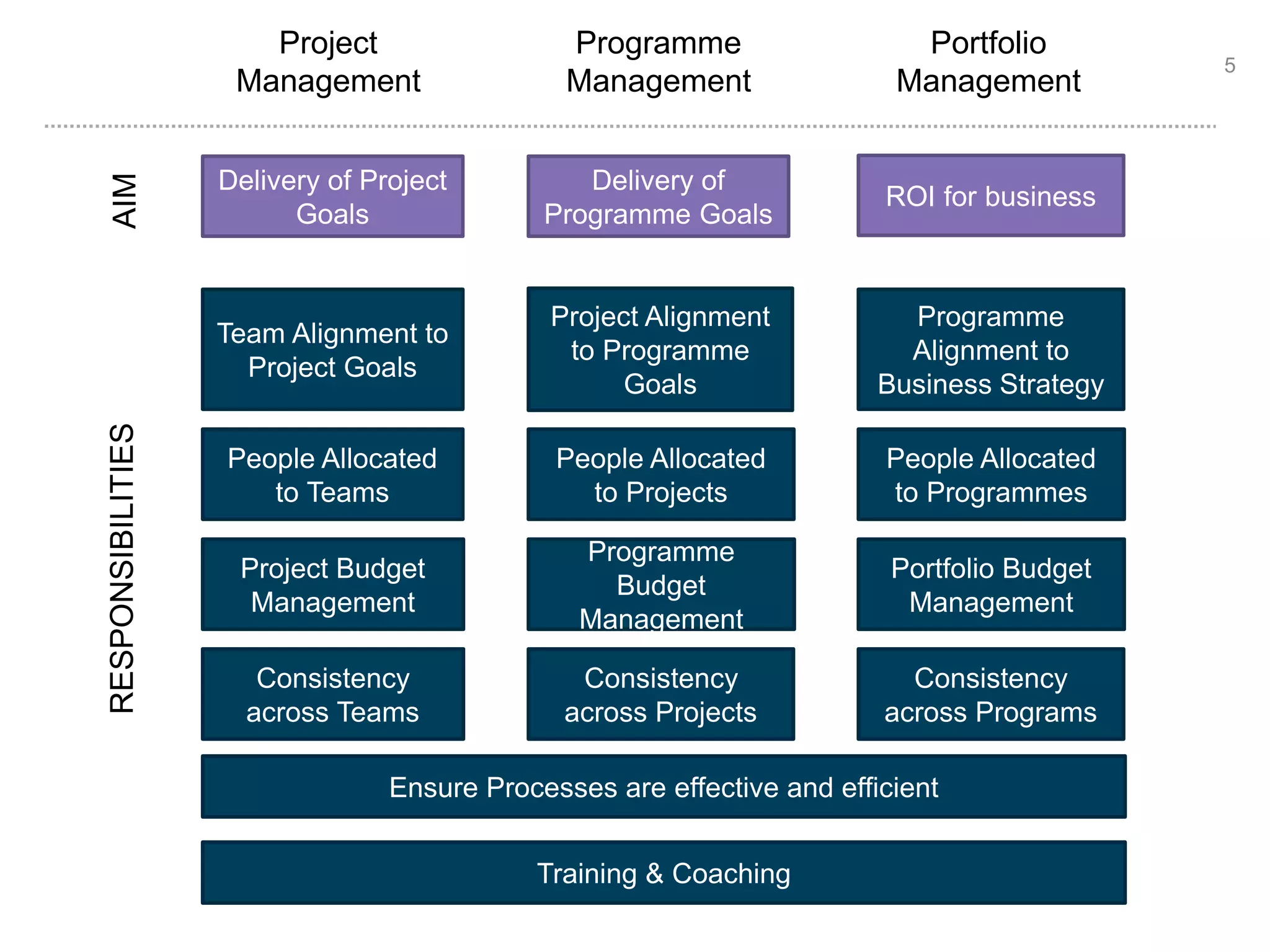

RESPONSIBILITIES AIM
Project
Management
Programme
Management
Portfolio
Management
Delivery of Project
Goals
Delivery of
Programme Goals
ROI for business
Team Alignment to
Project Goals
Project Alignment
to Programme
Goals
Programme
Alignment to
Business Strategy
People Allocated
to Programmes
Portfolio Budget
Management
Consistency
across Programs
People Allocated
to Projects
People Allocated
to Teams
Programme
Budget
Management
Consistency
across Projects
Project Budget
Management
Consistency
across Teams
Ensure Processes are effective and efficient
Training & Coaching
Project Management
7

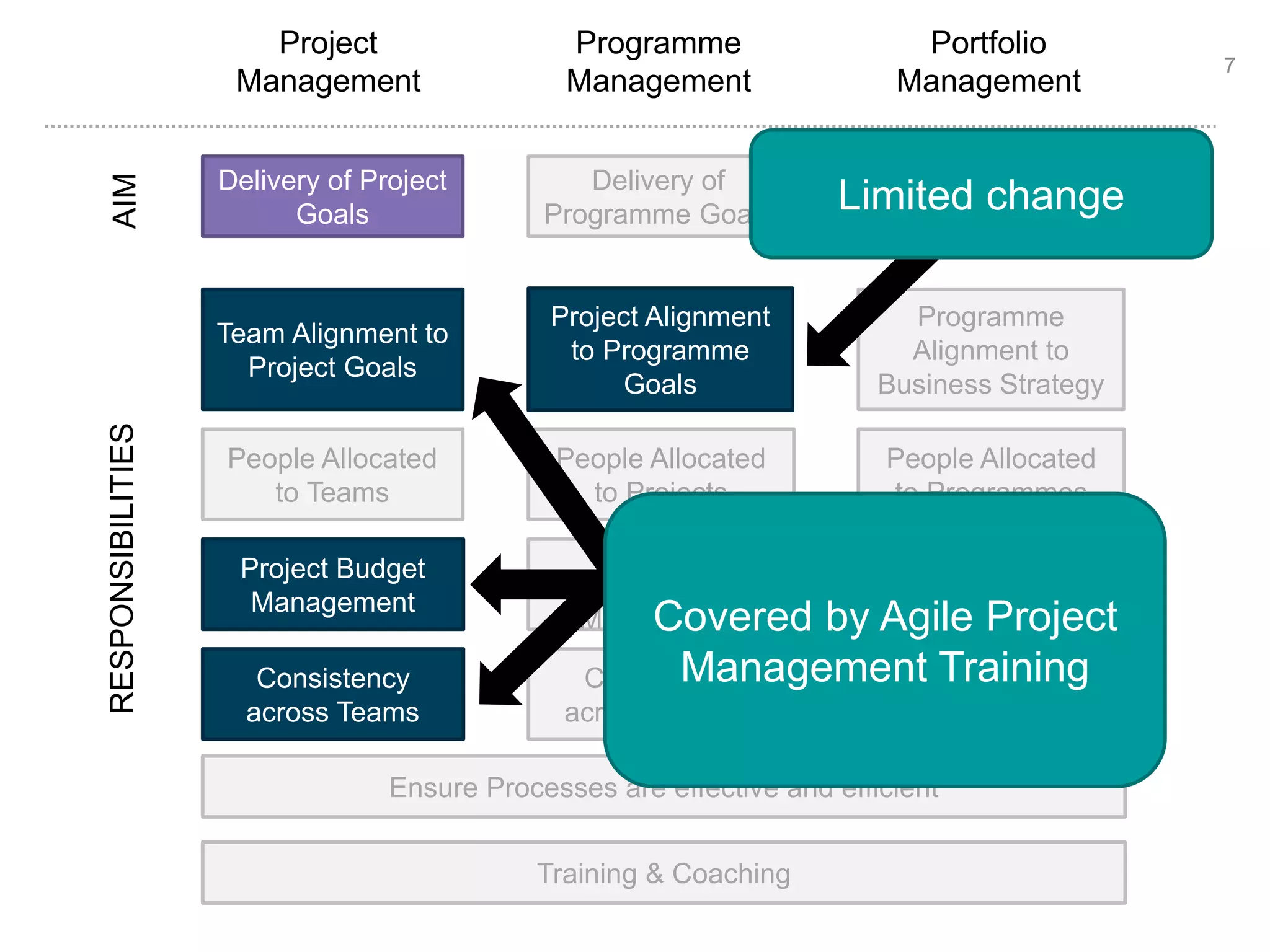

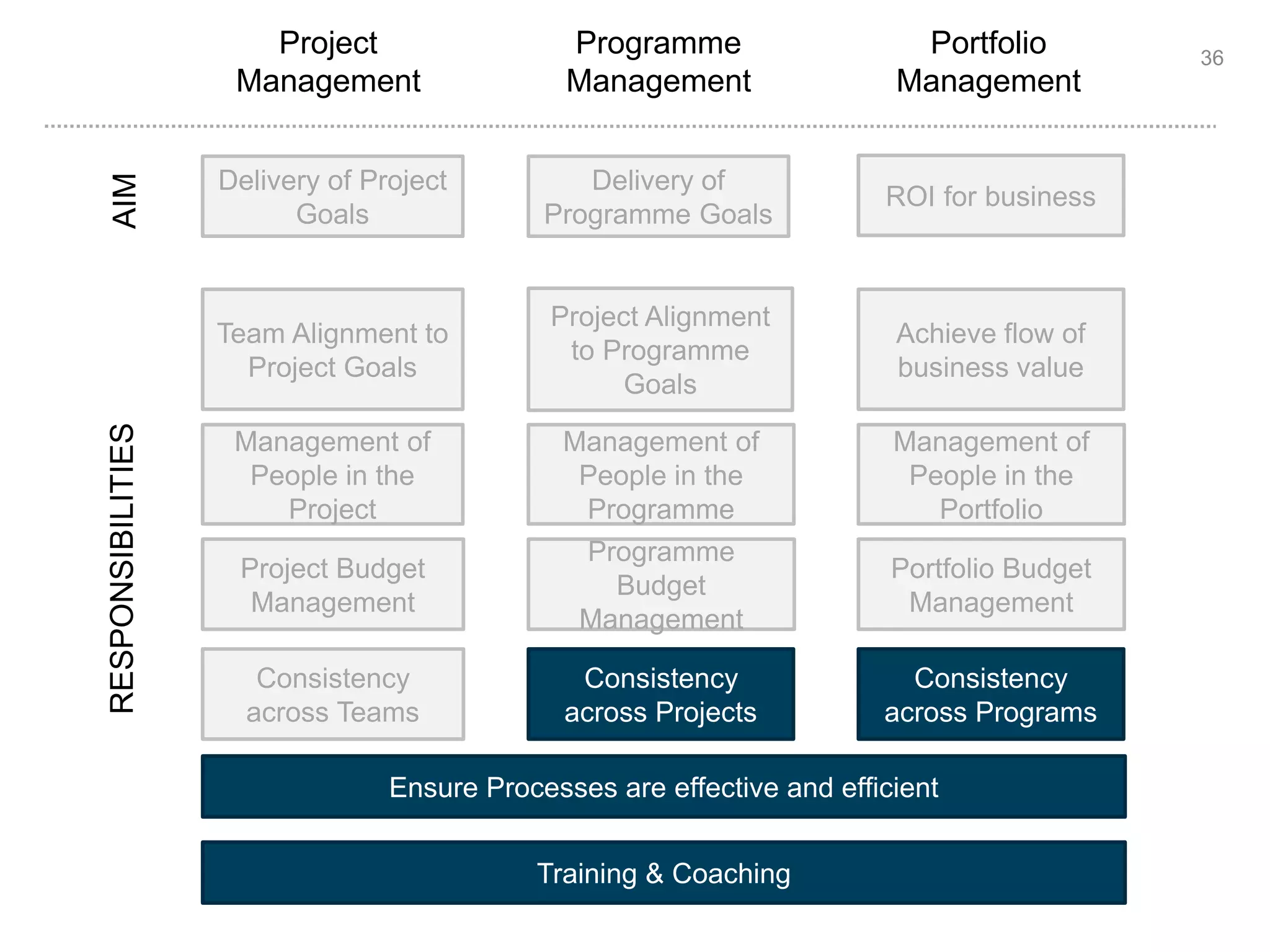

RESPONSIBILITIES AIM
Project
Management
Programme
Management
Portfolio
Management
Delivery of Project
Goals
Delivery of
Programme Goals
ROI for business
Team Alignment to
Project Goals
Project Alignment
to Programme
Goals
Programme
Alignment to
Business Strategy
People Allocated
to Programmes
Portfolio Budget
Management
Covered by Agile Project
Management Training
Consistency
across Programs
People Allocated
to Projects
People Allocated
to Teams
Consistency
across Projects
Consistency
across Teams
Programme
Budget
Management
Project Budget
Management
Ensure Processes are effective and efficient
Training & Coaching
Limited change
People Management
9

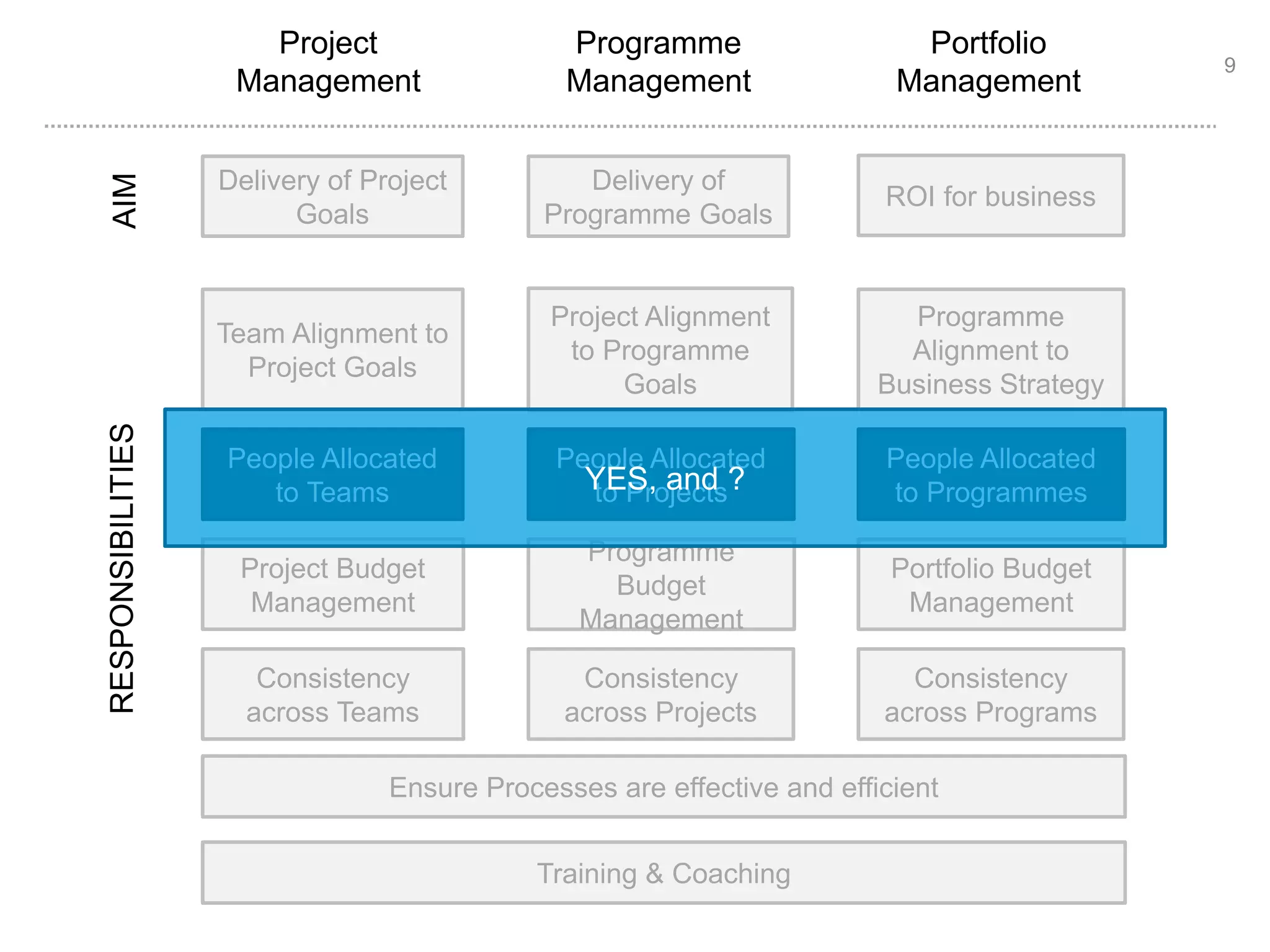

RESPONSIBILITIES AIM
Project
Management
Programme
Management
Portfolio
Management
Delivery of Project
Goals
Delivery of
Programme Goals
ROI for business
Team Alignment to
Project Goals
Project Alignment
to Programme
Goals
Programme
Alignment to
Business Strategy
People Allocated
to Programmes
Portfolio Budget
Management
Consistency
across Programs
People Allocated
to Projects
People Allocated
to Teams
Consistency
across Projects
Consistency
across Teams
Programme
Budget
Management
Project Budget
Management
YES, and ?
Ensure Processes are effective and efficient
Training & Coaching
10

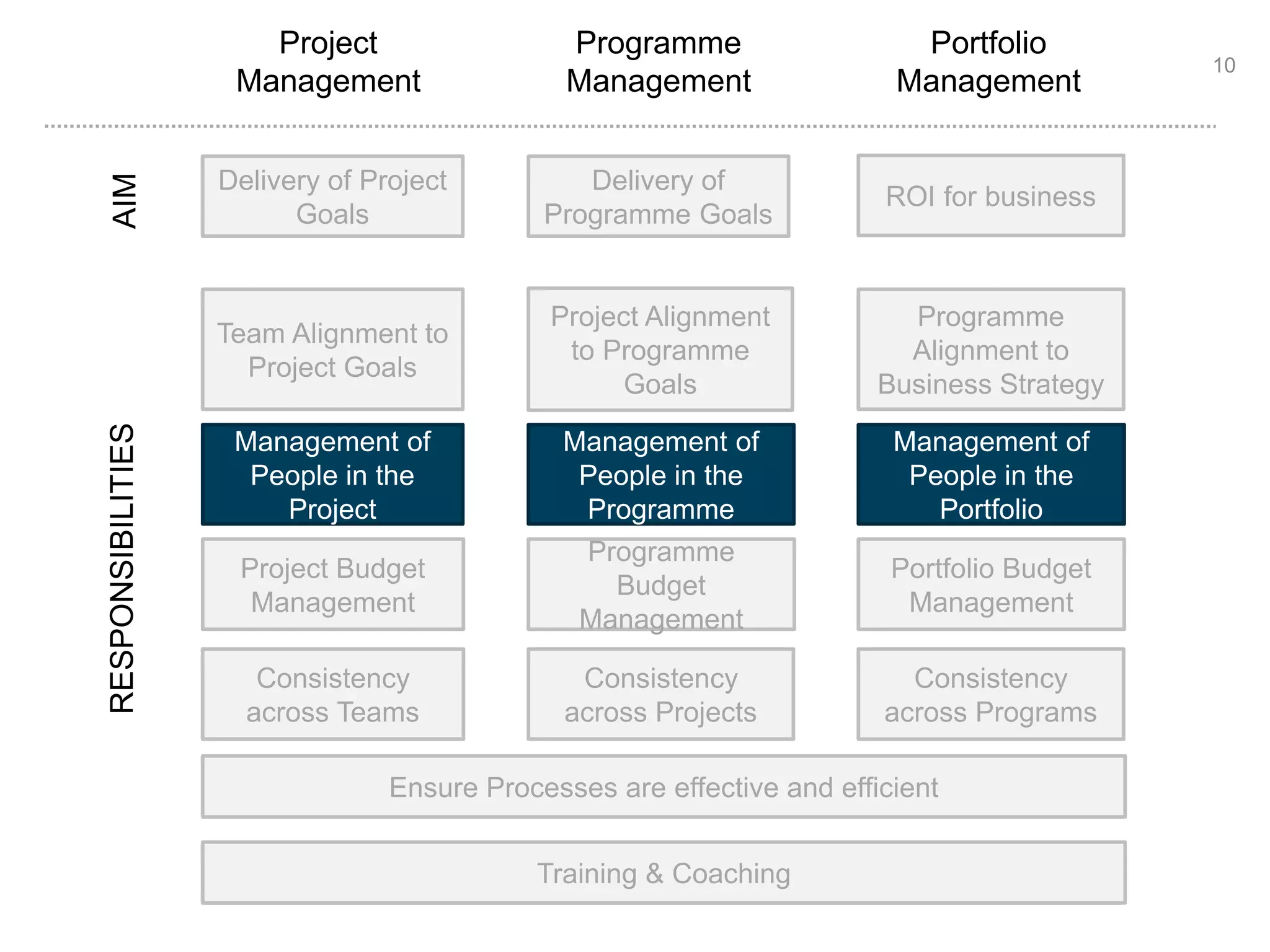

RESPONSIBILITIES AIM
Project
Management
Programme
Management
Portfolio
Management
Delivery of Project
Goals
Delivery of
Programme Goals
ROI for business
Team Alignment to
Project Goals
Project Alignment
to Programme
Goals
Programme
Alignment to
Business Strategy
Management of
People in the
Portfolio
Portfolio Budget
Management
Consistency
across Programs
Management of
People in the
Programme
Management of
People in the
Project
Consistency
across Projects
Consistency
across Teams
Programme
Budget
Management
Project Budget
Management
Ensure Processes are effective and efficient
Training & Coaching

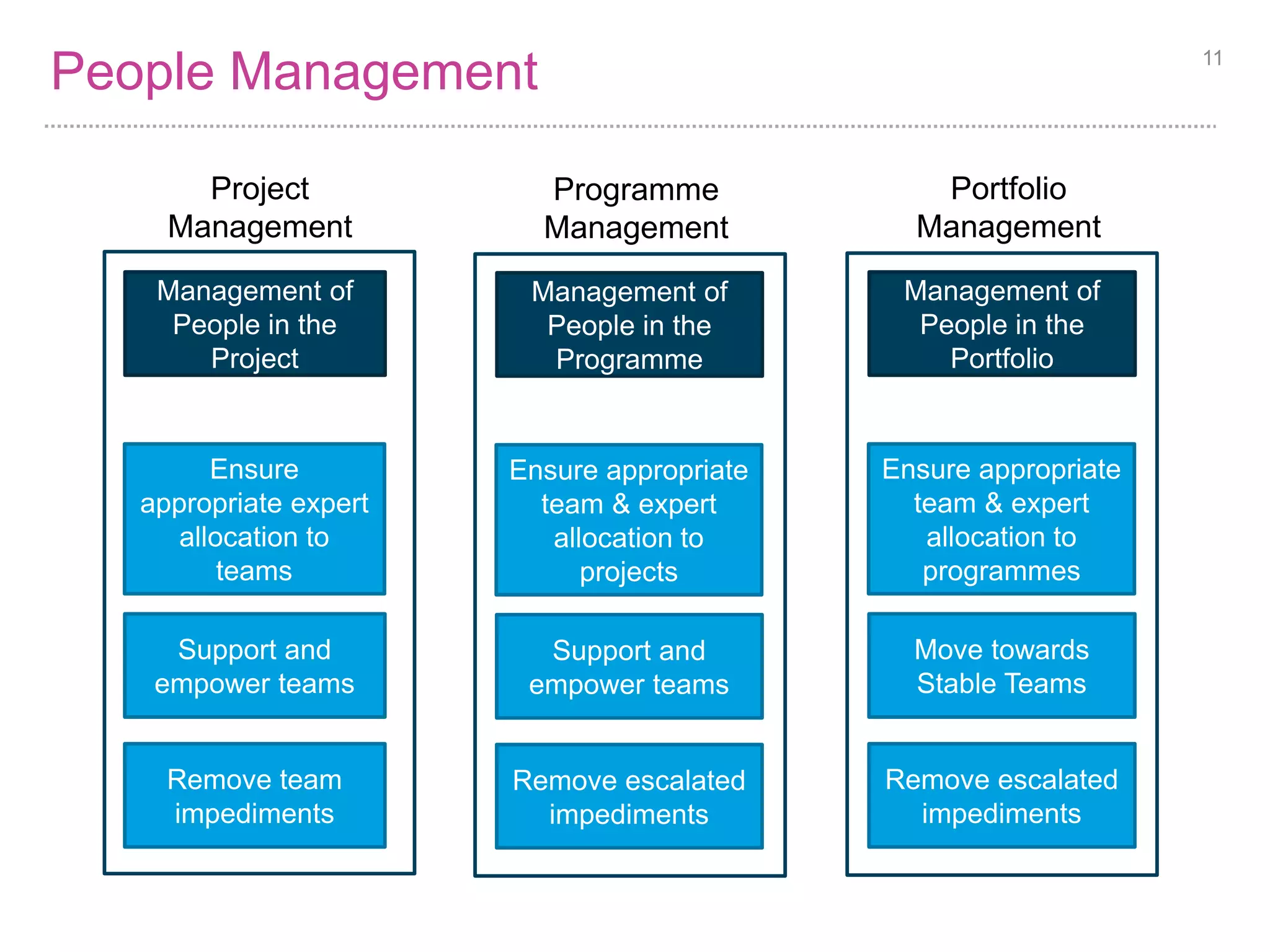

People Management 11
Project
Management
Programme
Management
Portfolio
Management
Management of
People in the
Portfolio
Management of
People in the
Programme
Management of
People in the
Project
Move towards
Stable Teams
Support and
empower teams
Support and
empower teams
Remove escalated
impediments
Remove escalated
impediments
Remove team
impediments
Ensure appropriate
team & expert
allocation to
programmes
Ensure appropriate
team & expert
allocation to
projects
Ensure
appropriate expert
allocation to
teams

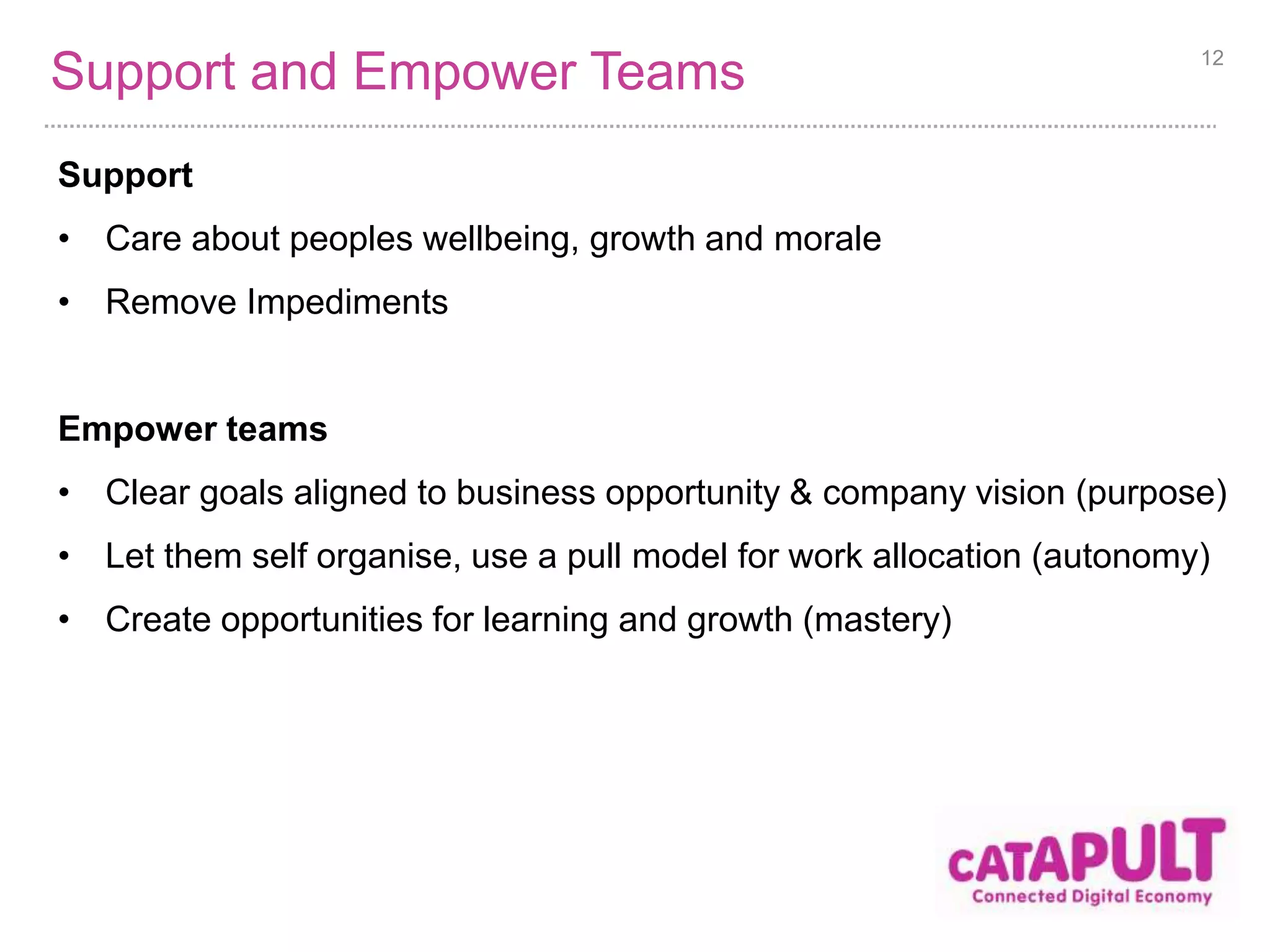

Support and Empower Teams
Support
• Care about peoples wellbeing, growth and morale
• Remove Impediments
12
Empower teams
• Clear goals aligned to business opportunity & company vision (purpose)
• Let them self organise, use a pull model for work allocation (autonomy)
• Create opportunities for learning and growth (mastery)

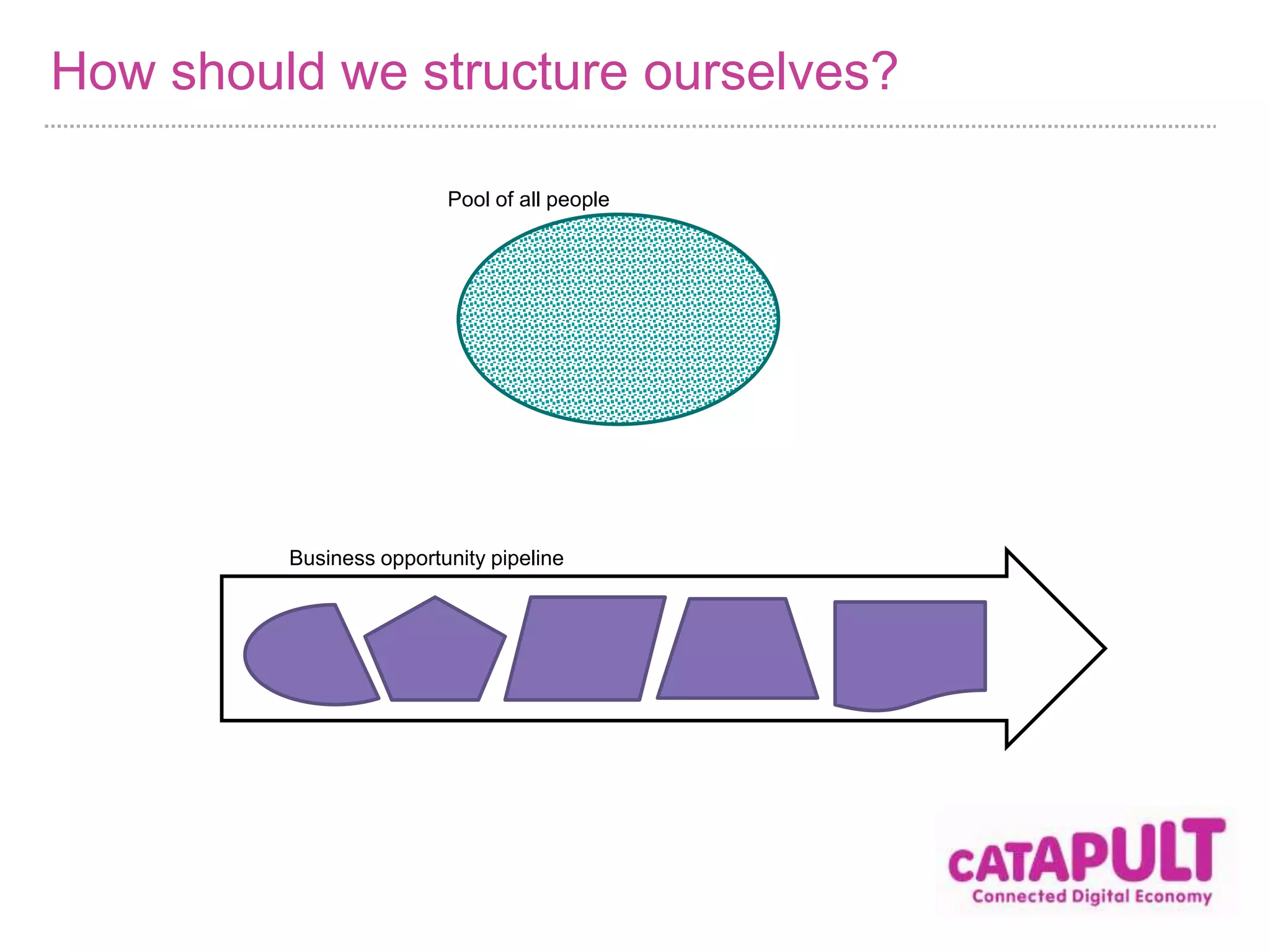

How should we structure ourselves?
Pool of all people

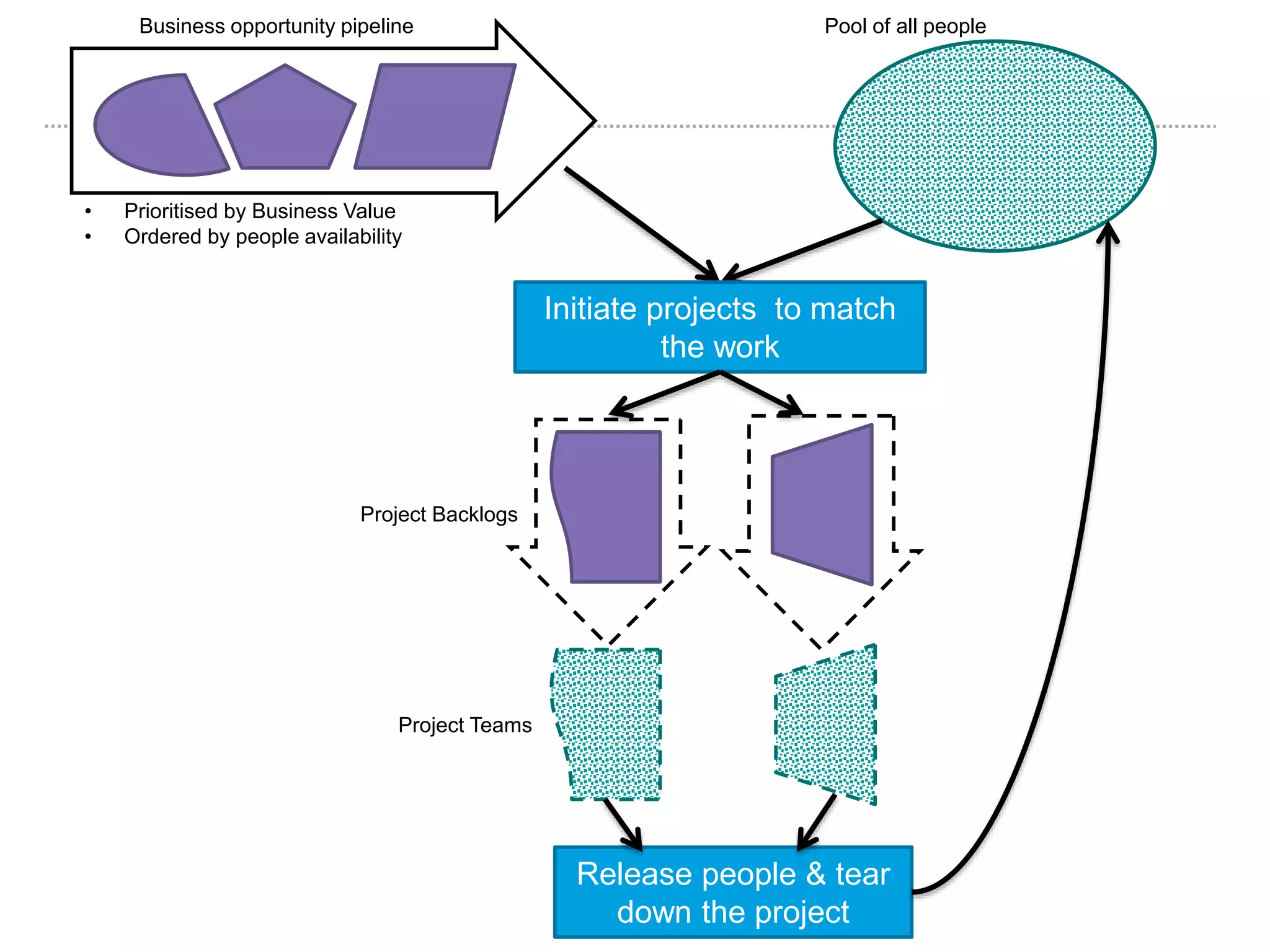

Business opportunity pipeline
Business opportunity pipeline Pool of all people
Initiate projects to match
the work
Release people & tear
down the project
• Prioritised by Business Value
• Ordered by people availability
Project Backlogs
Project Teams

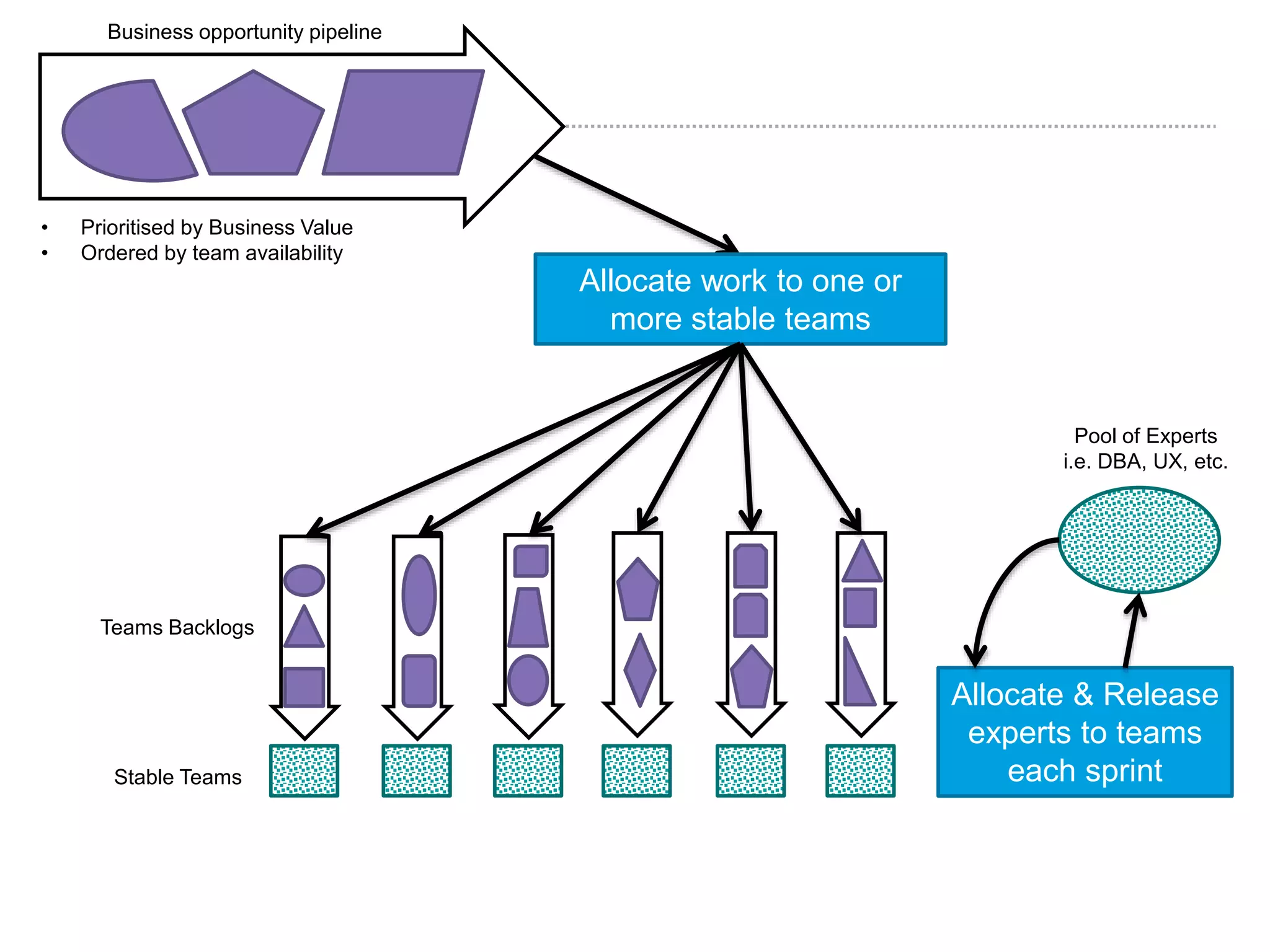

Allocate work to one or
more stable teams
• Prioritised by Business Value
• Ordered by team availability
Pool of Experts
i.e. DBA, UX, etc.
Business opportunity pipeline
Stable Teams
Allocate & Release
experts to teams
each sprint
Teams Backlogs

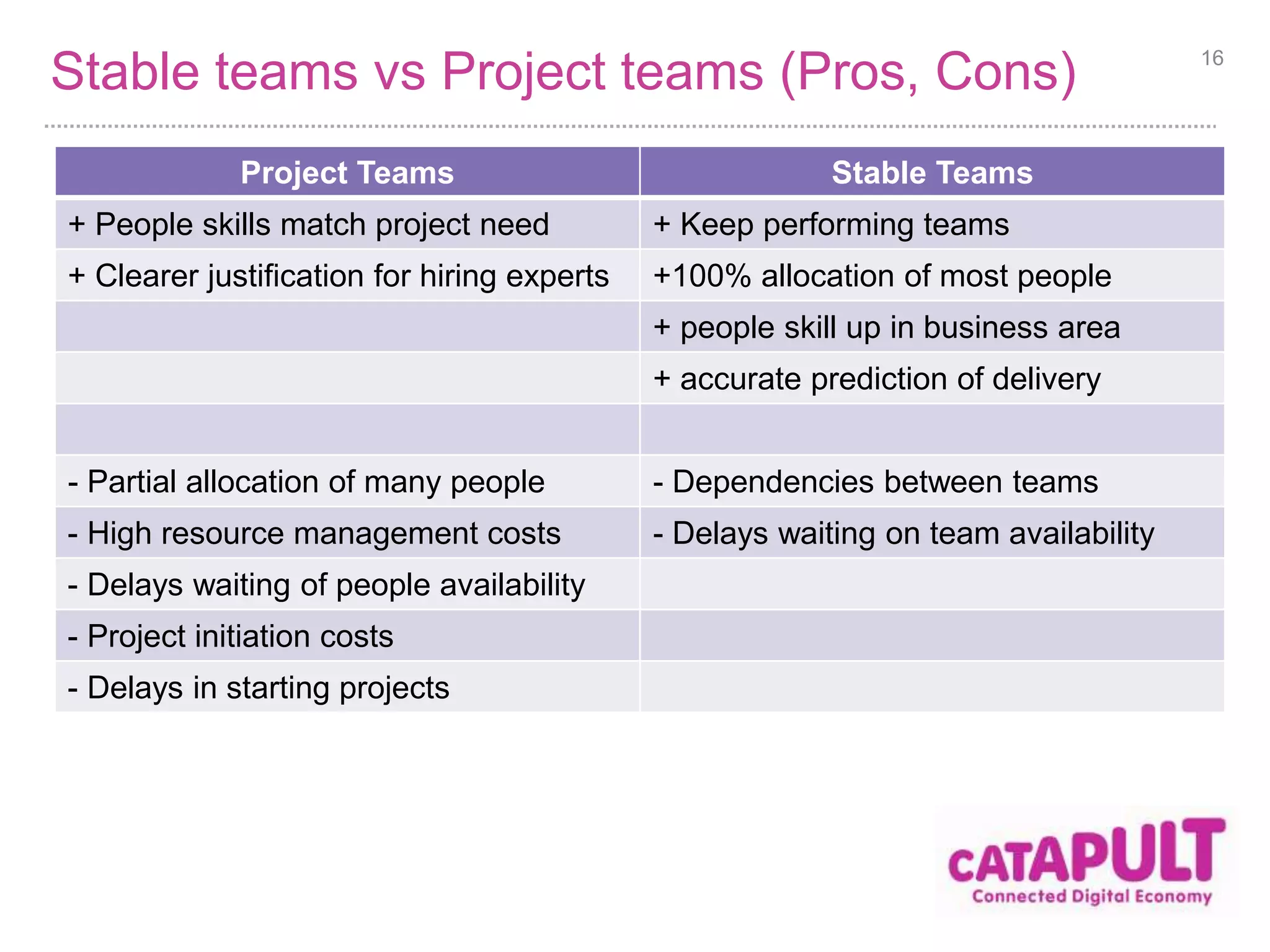

Stable teams vs Project teams (Pros, Cons) 16
Project Teams Stable Teams
+ People skills match project need + Keep performing teams
+ Clearer justification for hiring experts +100% allocation of most people
+ people skill up in business area
+ accurate prediction of delivery
- Partial allocation of many people - Dependencies between teams
- High resource management costs - Delays waiting on team availability
- Delays waiting of people availability
- Project initiation costs
- Delays in starting projects

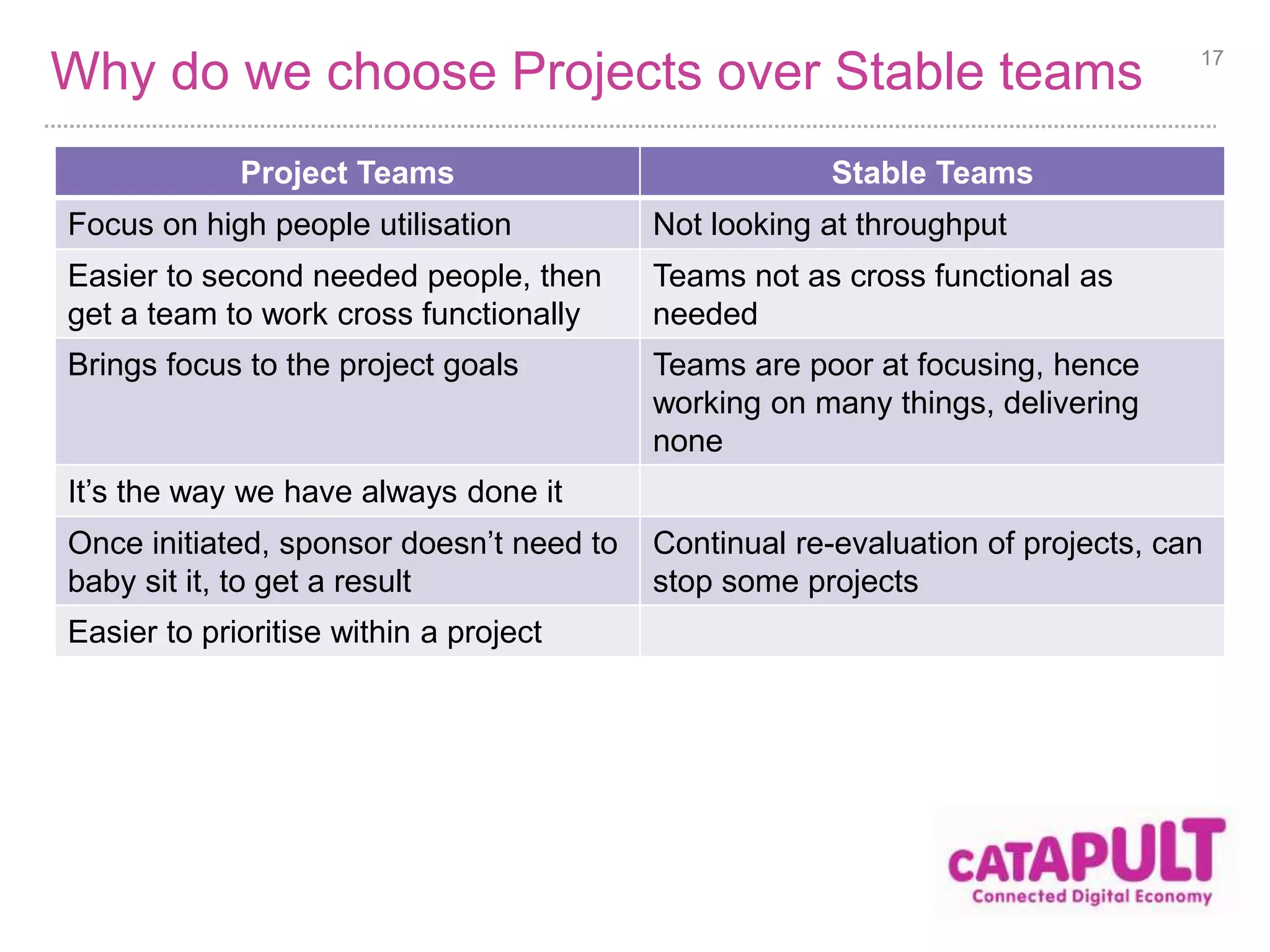

Why do we choose Projects over Stable teams 17
Project Teams Stable Teams
Focus on high people utilisation Not looking at throughput
Easier to second needed people, then
get a team to work cross functionally
Teams not as cross functional as
needed
Brings focus to the project goals Teams are poor at focusing, hence
working on many things, delivering
none
It’s the way we have always done it
Once initiated, sponsor doesn’t need to
baby sit it, to get a result
Continual re-evaluation of projects, can
stop some projects
Easier to prioritise within a project
Portfolio Management
19

RESPONSIBILITIES AIM
Project
Management
Programme
Management
Portfolio
Management
Delivery of Project
Goals
Delivery of
Programme Goals
ROI for business
Team Alignment to
Project Goals
Project Alignment
to Programme
Goals
Programme
Alignment to
Business Strategy
Management of
People in the
Portfolio
Portfolio Budget
Management
Consistency
across Programs
Management of
People in the
Programme
Management of
People in the
Project
Consistency
across Projects
Consistency
across Teams
Programme
Budget
Management
Project Budget
Management
YES, and ?
Ensure Processes are effective and efficient
Training & Coaching
20
RESPONSIBILITIES AIM
Project
Management
Programme
Management
Portfolio
Management
Delivery of Project
Goals
Delivery of
Programme Goals
ROI for business
Team Alignment to
Project Goals
Project Alignment
to Programme
Goals
Achieve flow of
business value
Management of
People in the
Portfolio
Portfolio Budget
Management
Consistency
across Programs
Management of
People in the
Programme
Management of
People in the
Project
Consistency
across Projects
Consistency
across Teams
Programme
Budget
Management
Project Budget
Management
Ensure Processes are effective and efficient
Training & Coaching

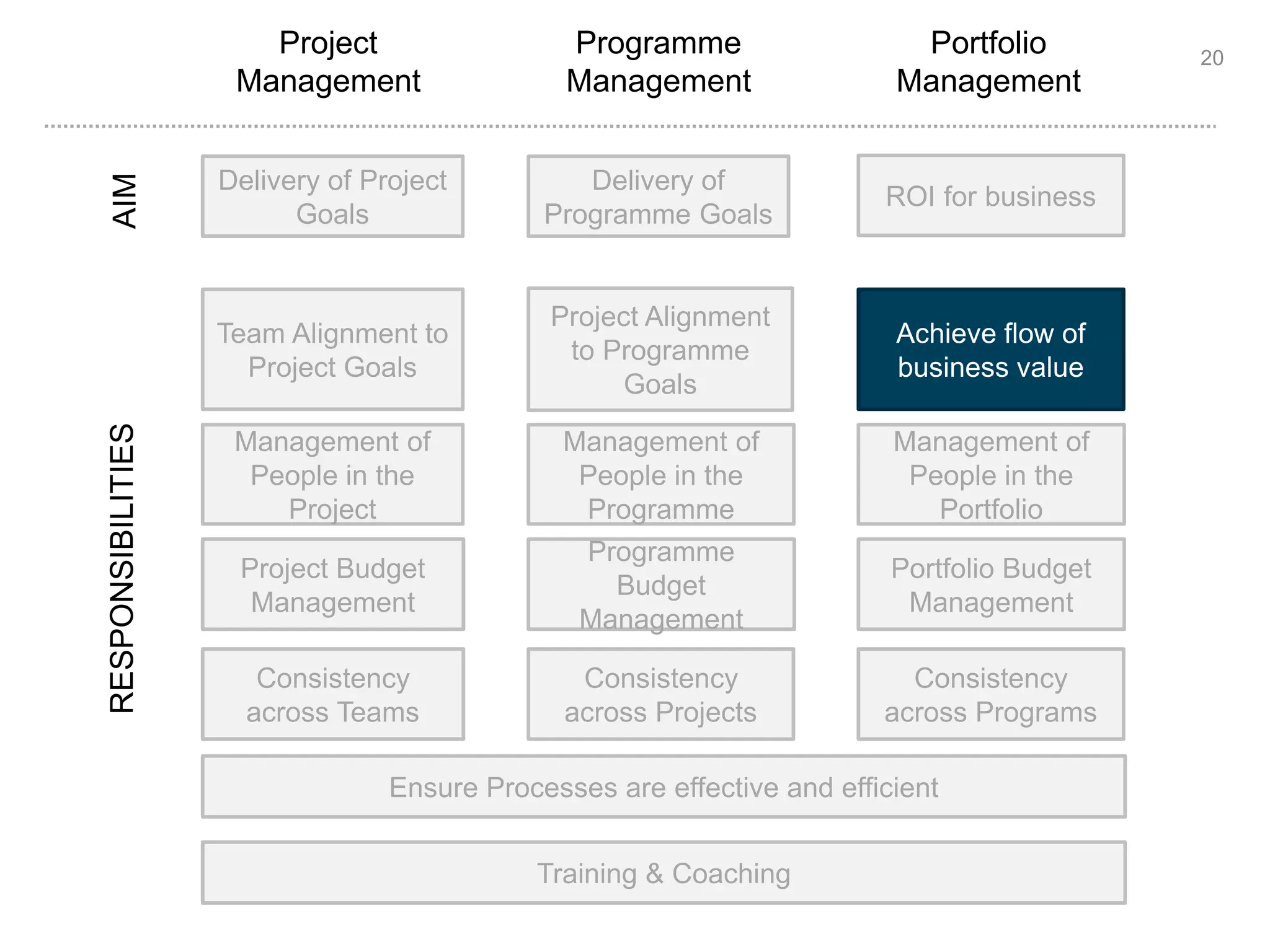

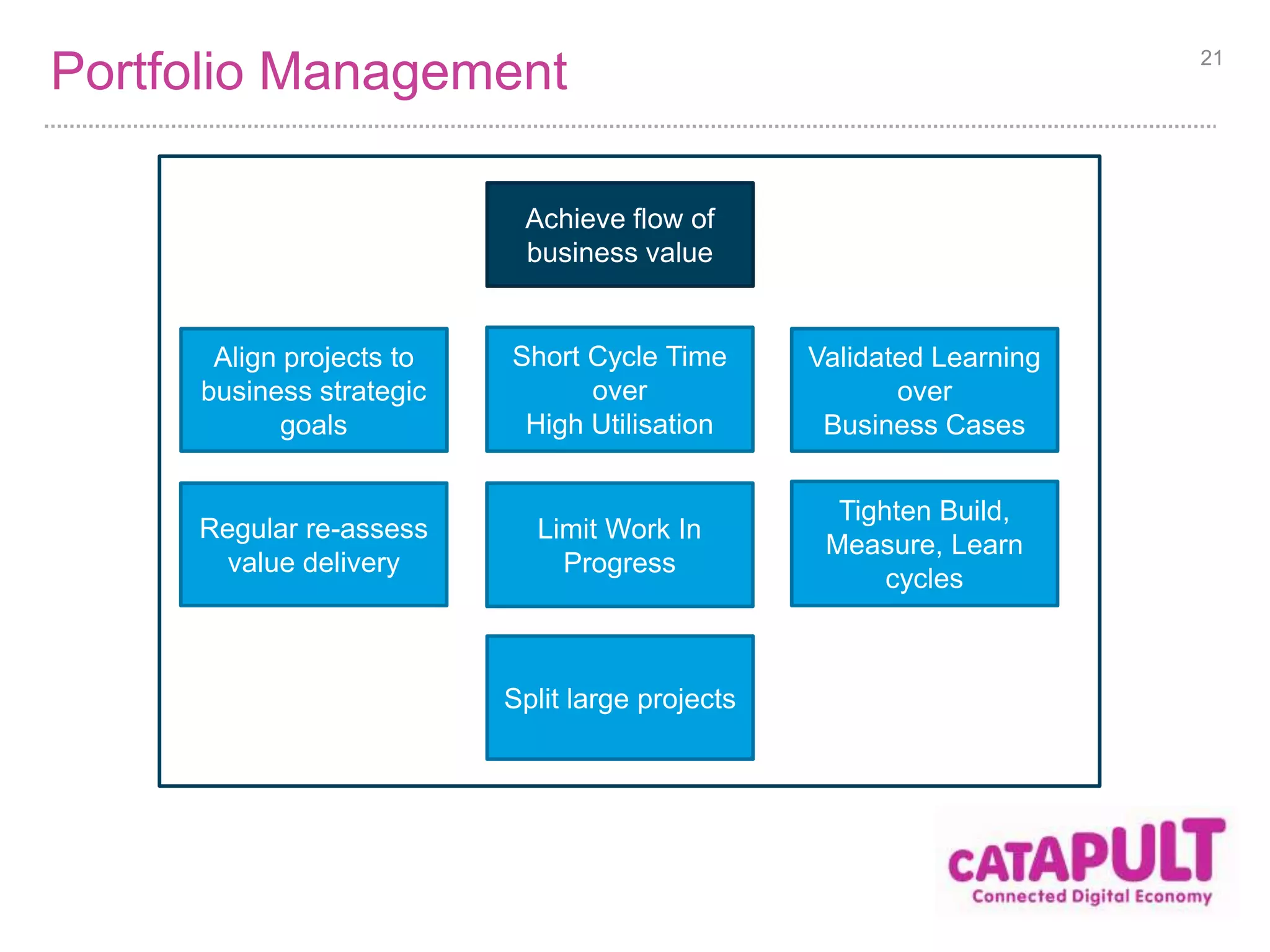

Portfolio Management 21
Achieve flow of
business value
Align projects to
business strategic
goals
Short Cycle Time
over
High Utilisation
Split large projects
Validated Learning
over
Business Cases
Tighten Build,
Measure, Learn
cycles
Limit Work In
Progress
Regular re-assess
value delivery

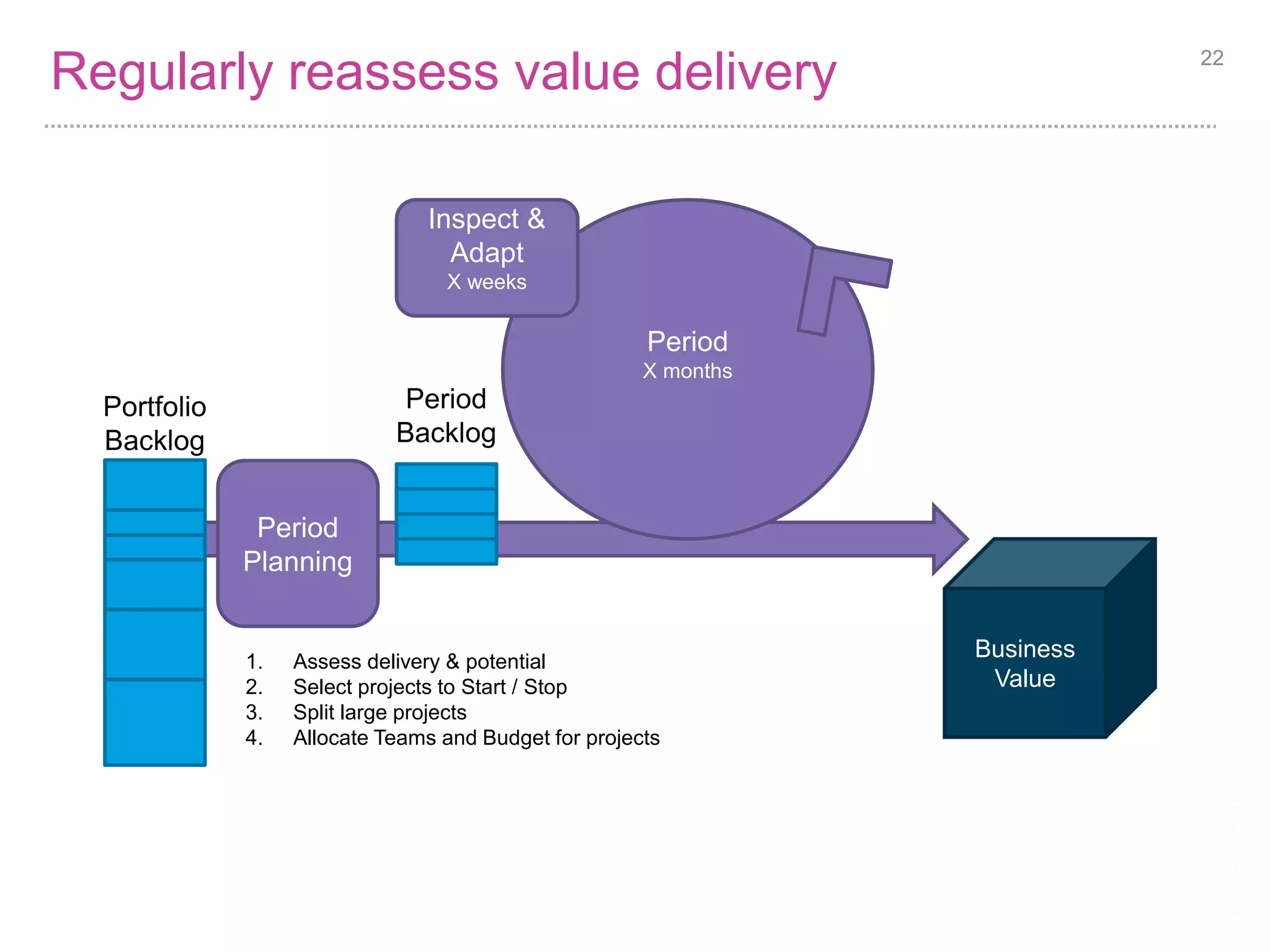

Regularly reassess value delivery 22
Period
X months
Period
Planning
Inspect &
Adapt
X weeks
Business
Value
Portfolio
Backlog
Period
Backlog
1. Assess delivery & potential
2. Select projects to Start / Stop
3. Split large projects
4. Allocate Teams and Budget for projects

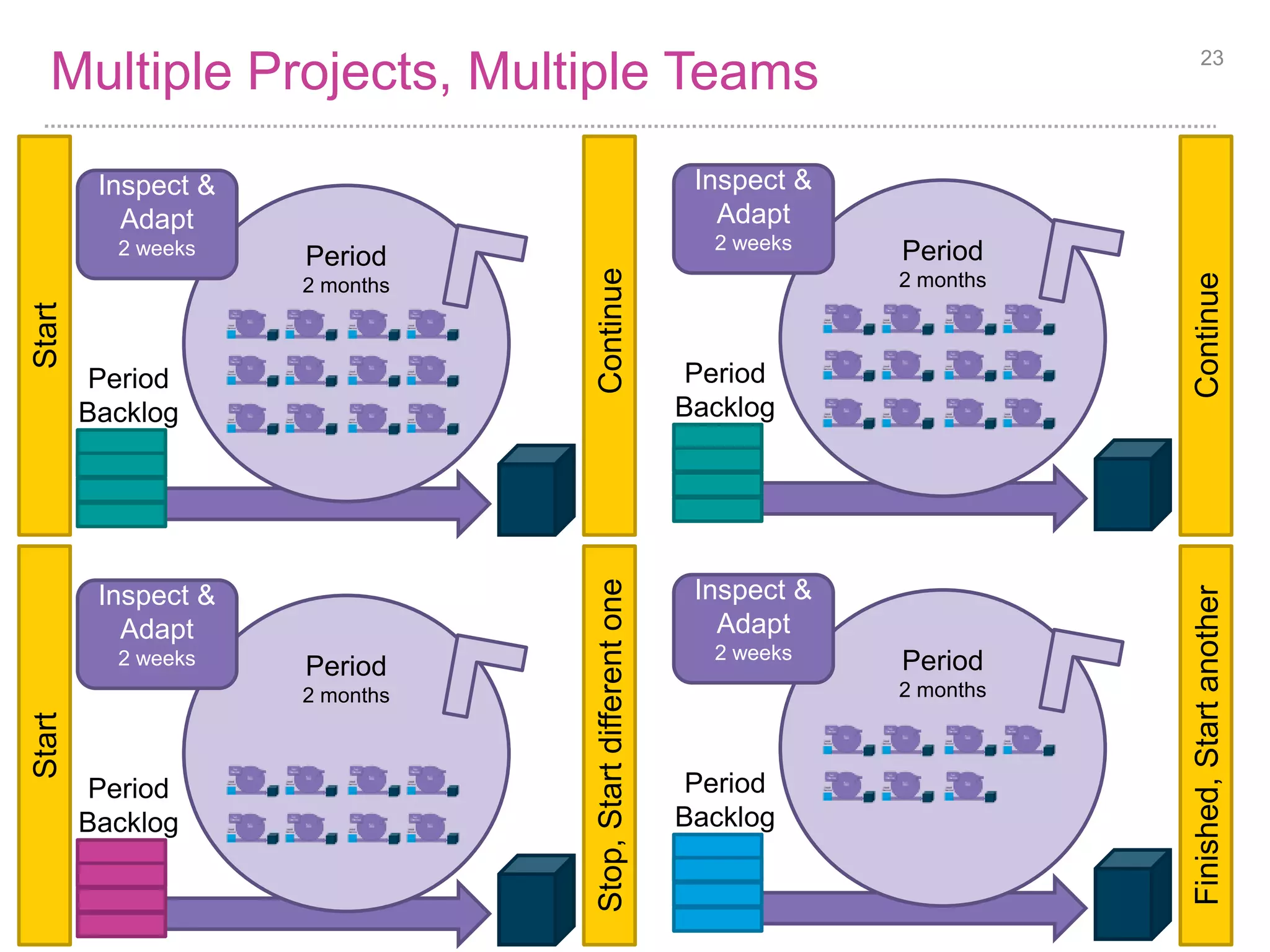

Multiple Projects, Multiple Teams 23
Period
2 months
Inspect &
Adapt
2 weeks
Period
Backlog
Start
Continue
Period
2 months
Inspect &
Adapt
2 weeks
Period
Backlog
Continue
Period
2 months
Inspect &
Adapt
2 weeks
Period
Backlog
Start
Stop, Start different one
Period
2 months
Inspect &
Adapt
2 weeks
Period
Backlog
Finished, Start another

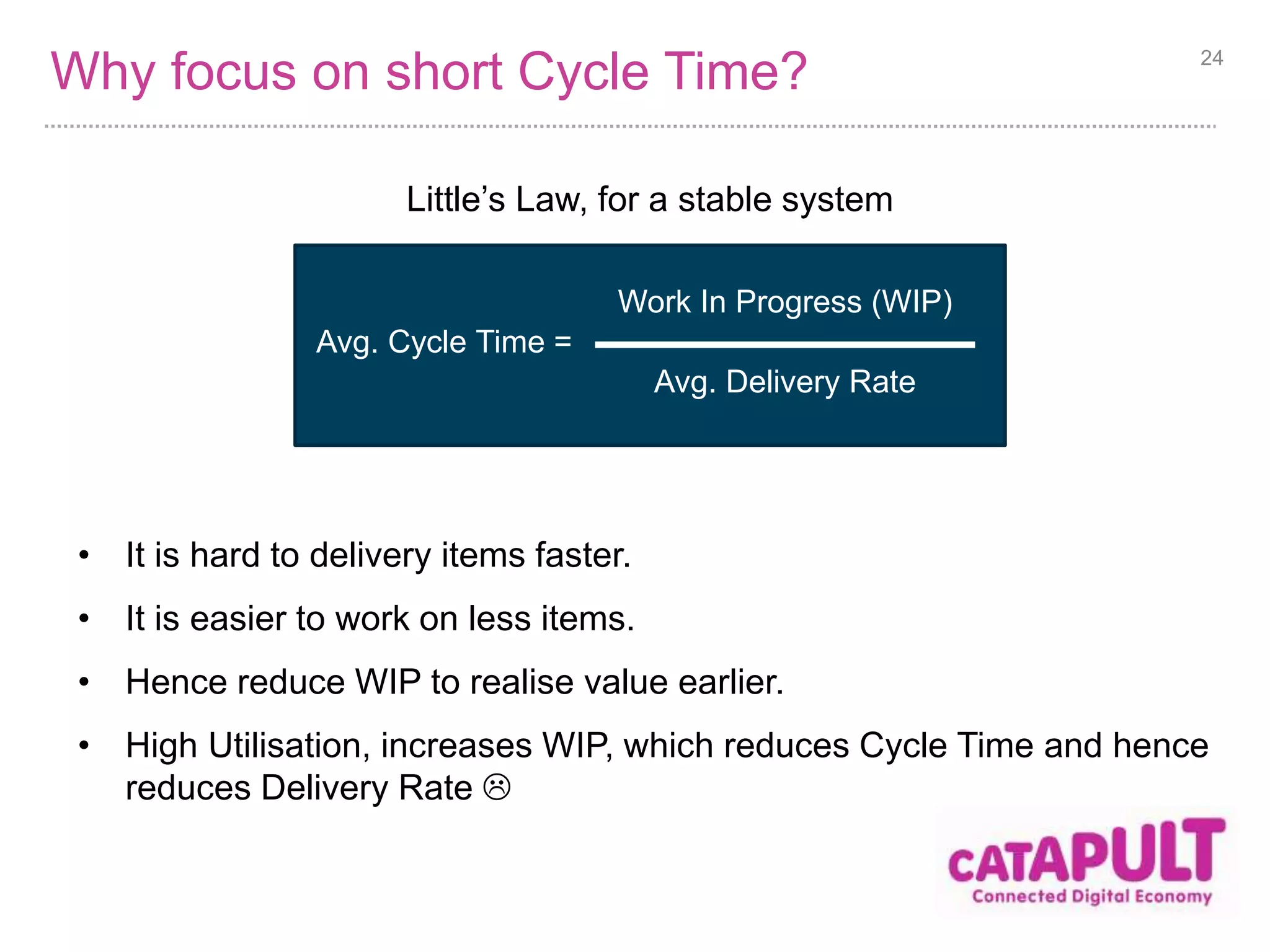

Why focus on short Cycle Time?
Little’s Law, for a stable system
• It is hard to delivery items faster.
• It is easier to work on less items.
• Hence reduce WIP to realise value earlier.
• High Utilisation, increases WIP, which reduces Cycle Time and hence
reduces Delivery Rate 
24
Avg. Cycle Time =
Work In Progress (WIP)
Avg. Delivery Rate
How do we limit WIP? 25
1. Stop some projects
2. Reduce the projects that Start/Continue
Portfolio
Backlog
Period
Backlog
Our capacity
Period
Planning

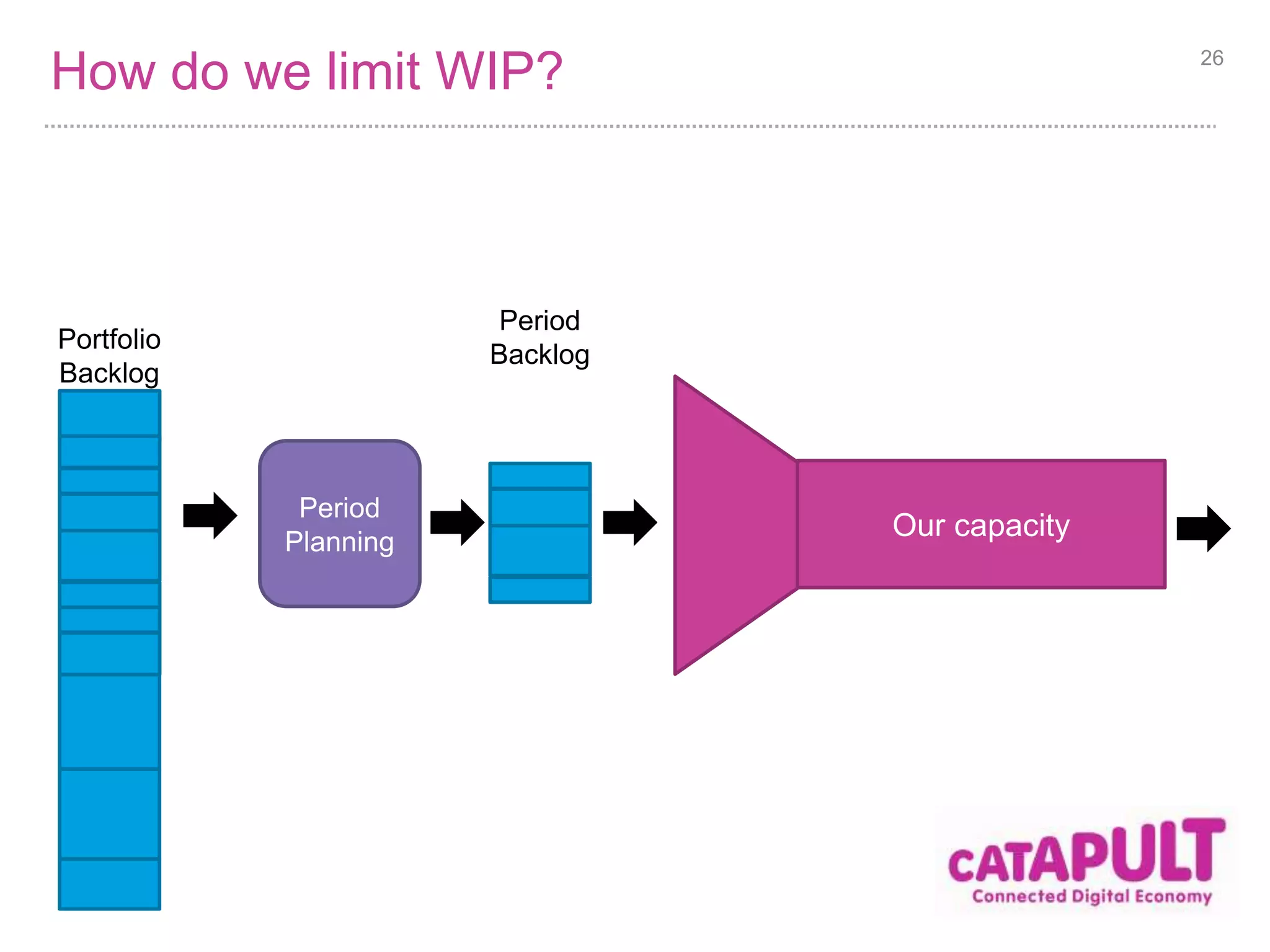

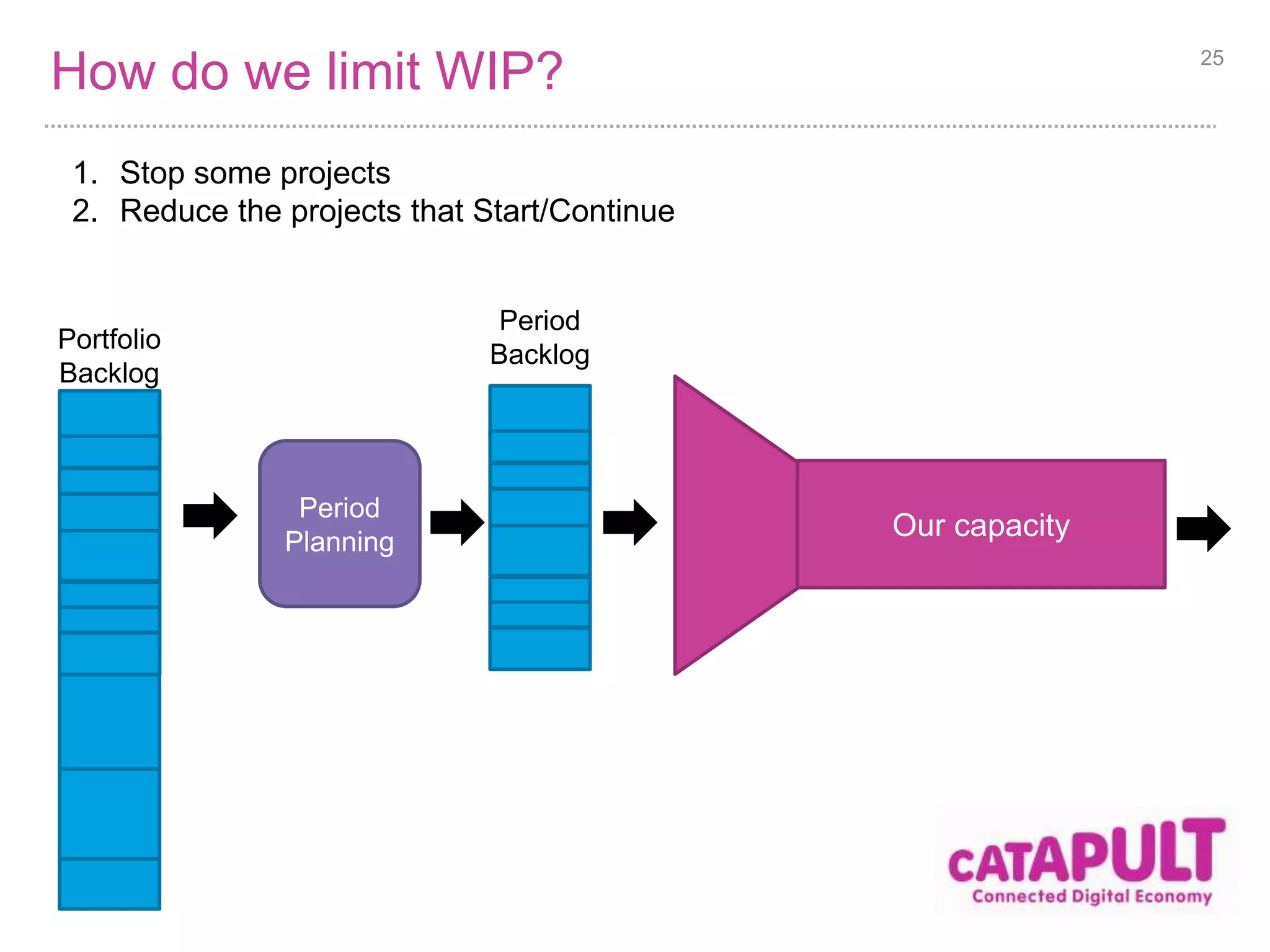

How do we limit WIP? 26
Portfolio
Backlog
Period
Backlog
Our capacity
Period
Planning

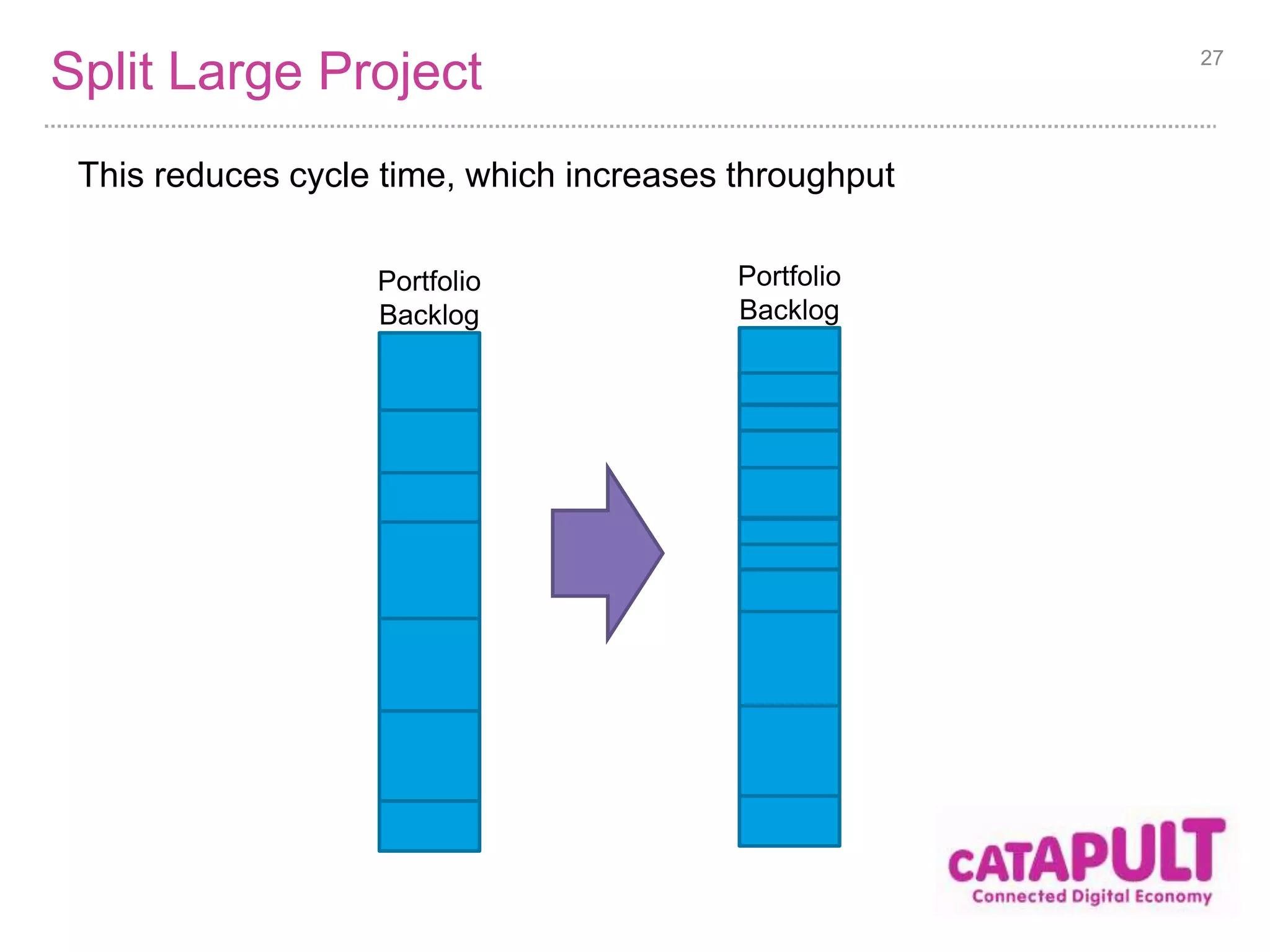

Split Large Project
This reduces cycle time, which increases throughput
27
Portfolio
Backlog
Portfolio
Backlog

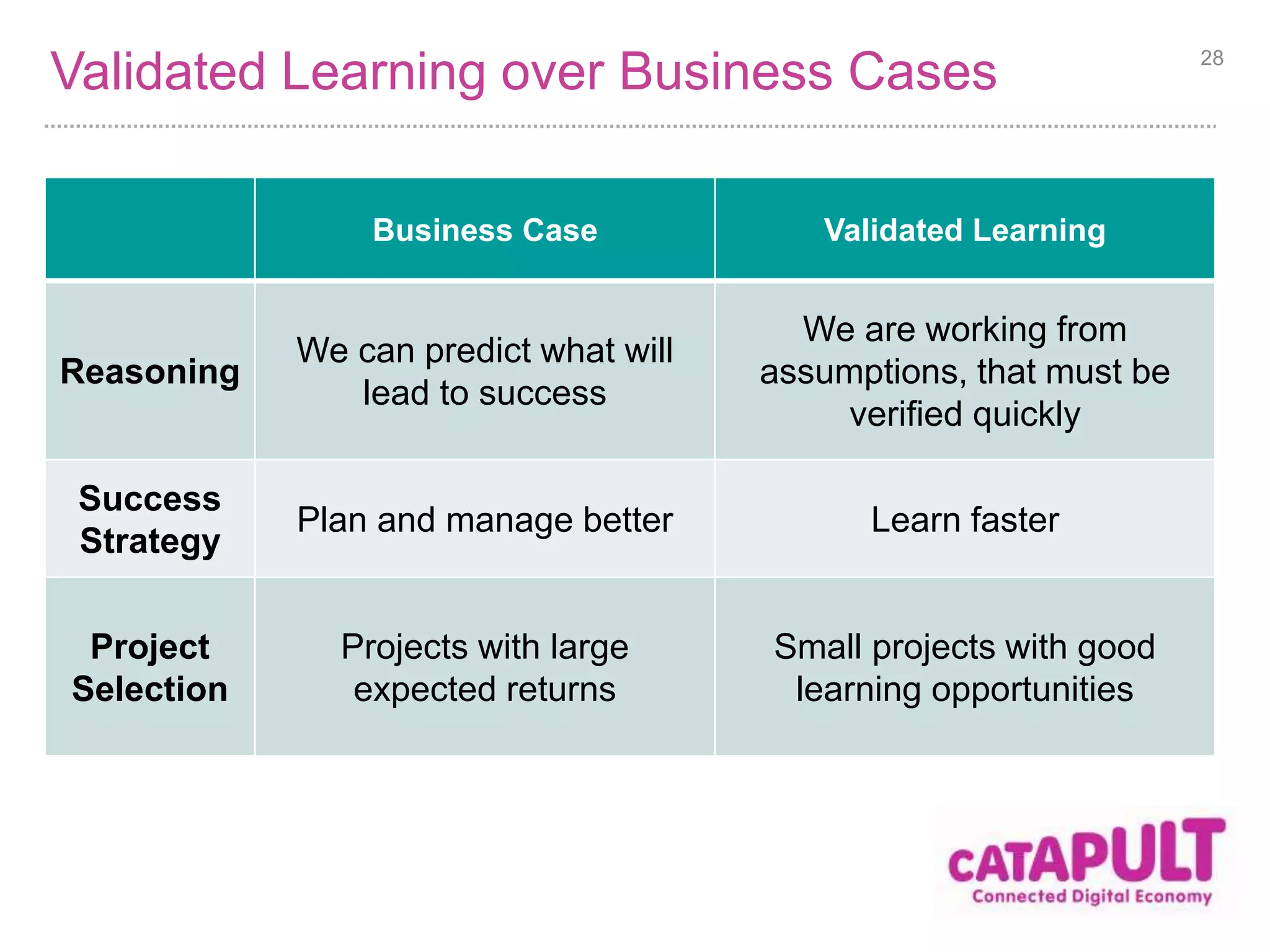

Validated Learning over Business Cases
Business Case Validated Learning
Reasoning
We can predict what will
lead to success
We are working from
assumptions, that must be
verified quickly
Success
Strategy
Plan and manage better Learn faster
Project
Selection
Projects with large
expected returns
Small projects with good
learning opportunities
28

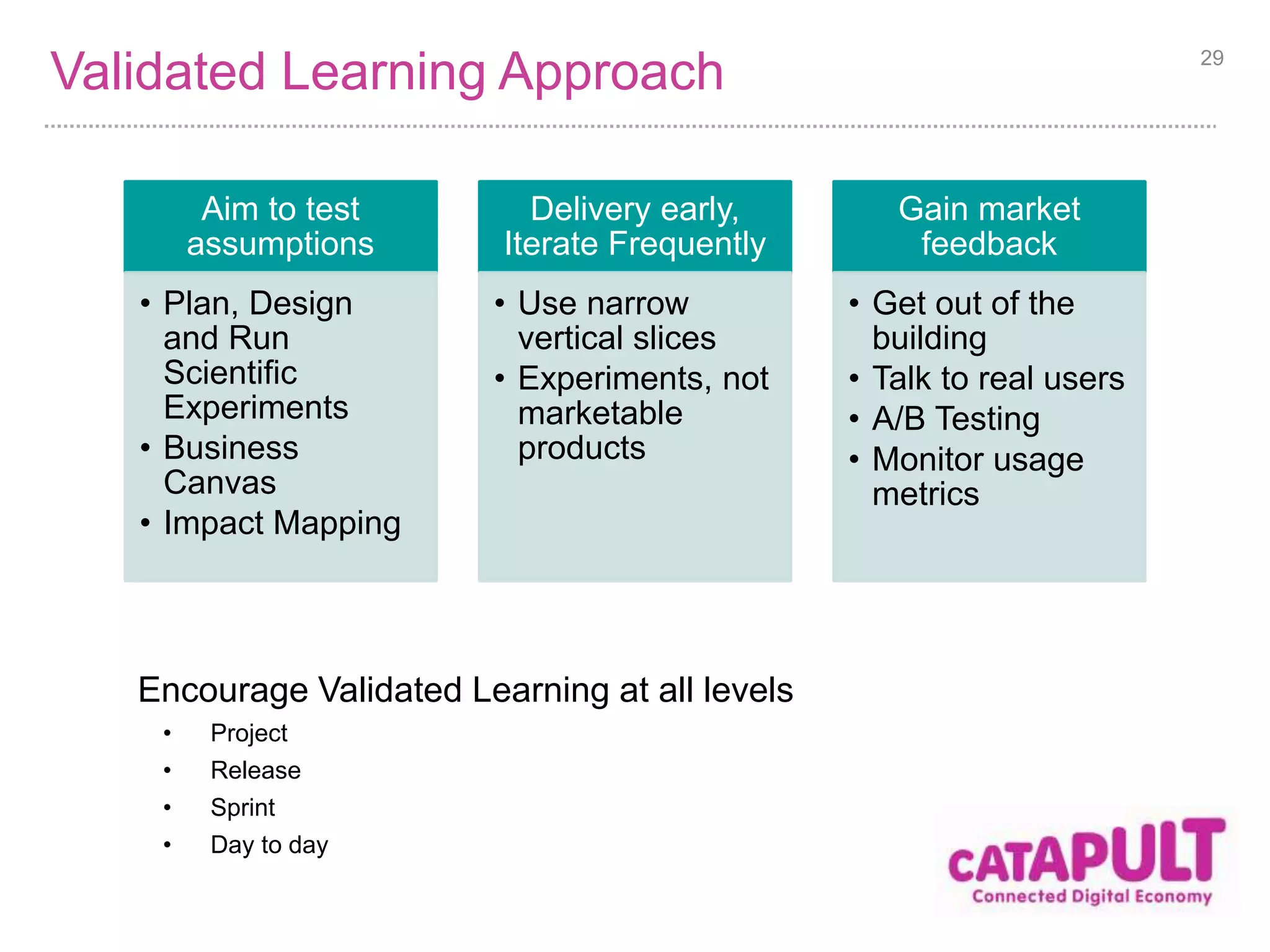

Validated Learning Approach
Encourage Validated Learning at all levels
• Project
• Release
• Sprint
• Day to day
29
Aim to test
assumptions
• Plan, Design
and Run
Scientific
Experiments
• Business
Canvas
• Impact Mapping
Delivery early,
Iterate Frequently
• Use narrow
vertical slices
• Experiments, not
marketable
products
Gain market
feedback
• Get out of the
building
• Talk to real users
• A/B Testing
• Monitor usage
metrics

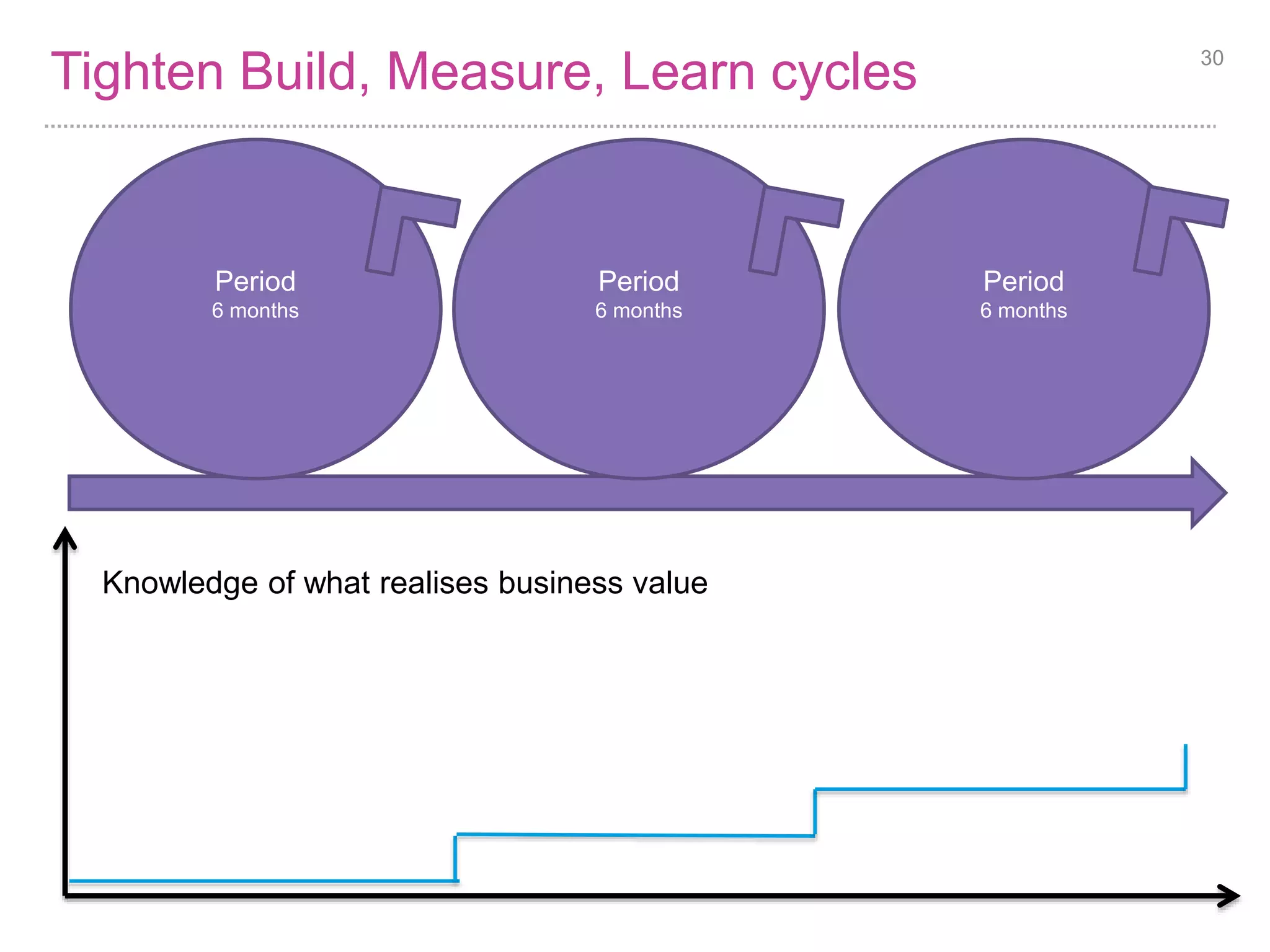

Tighten Build, Measure, Learn cycles 30
Period
6 months
Period
6 months
Knowledge of what realises business value
Period
6 months

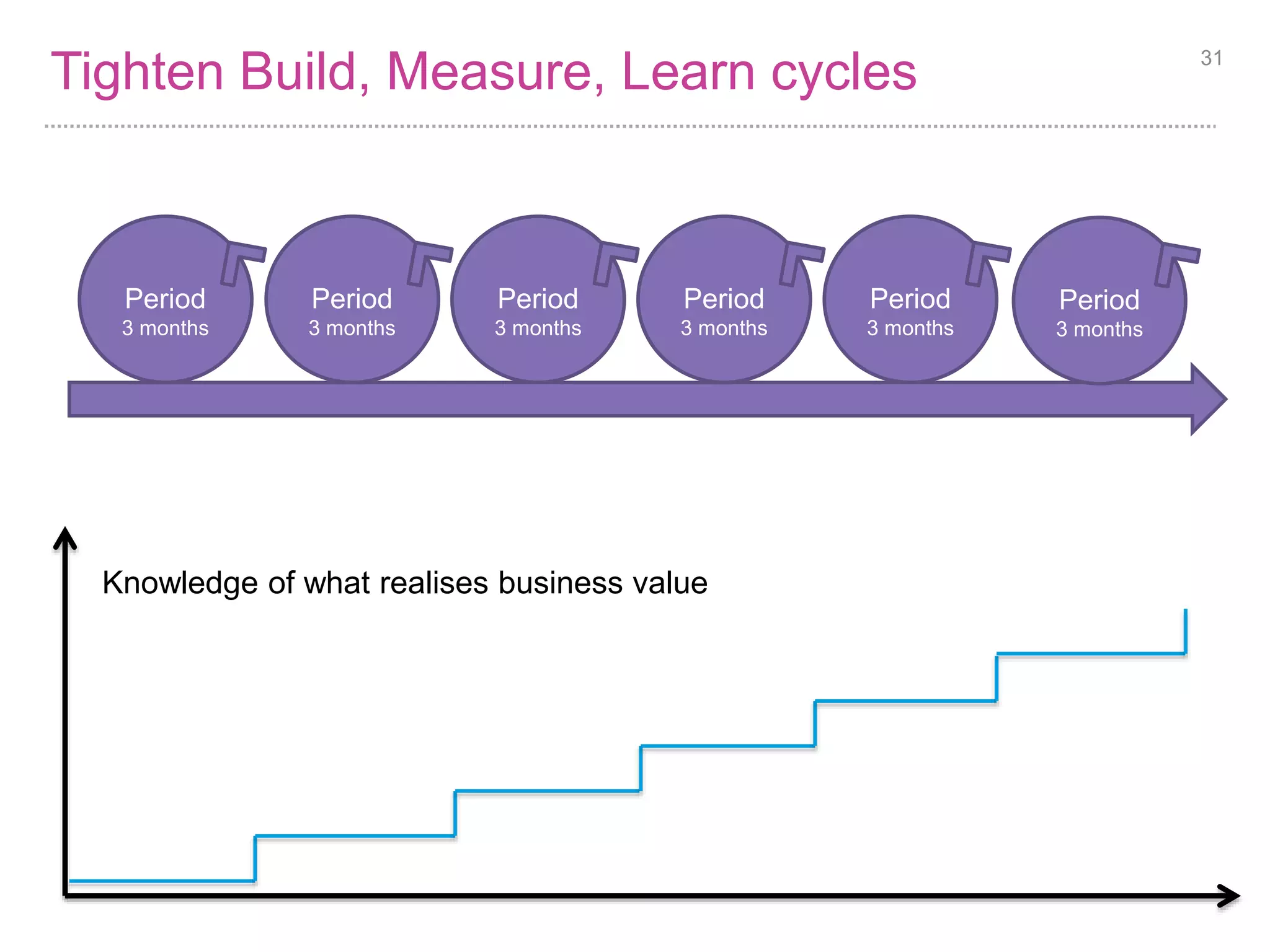

Tighten Build, Measure, Learn cycles 31
Period
3 months
Period
3 months
Period
3 months
Period
3 months
Period
3 months
Period
3 months
Knowledge of what realises business value
Budget Management

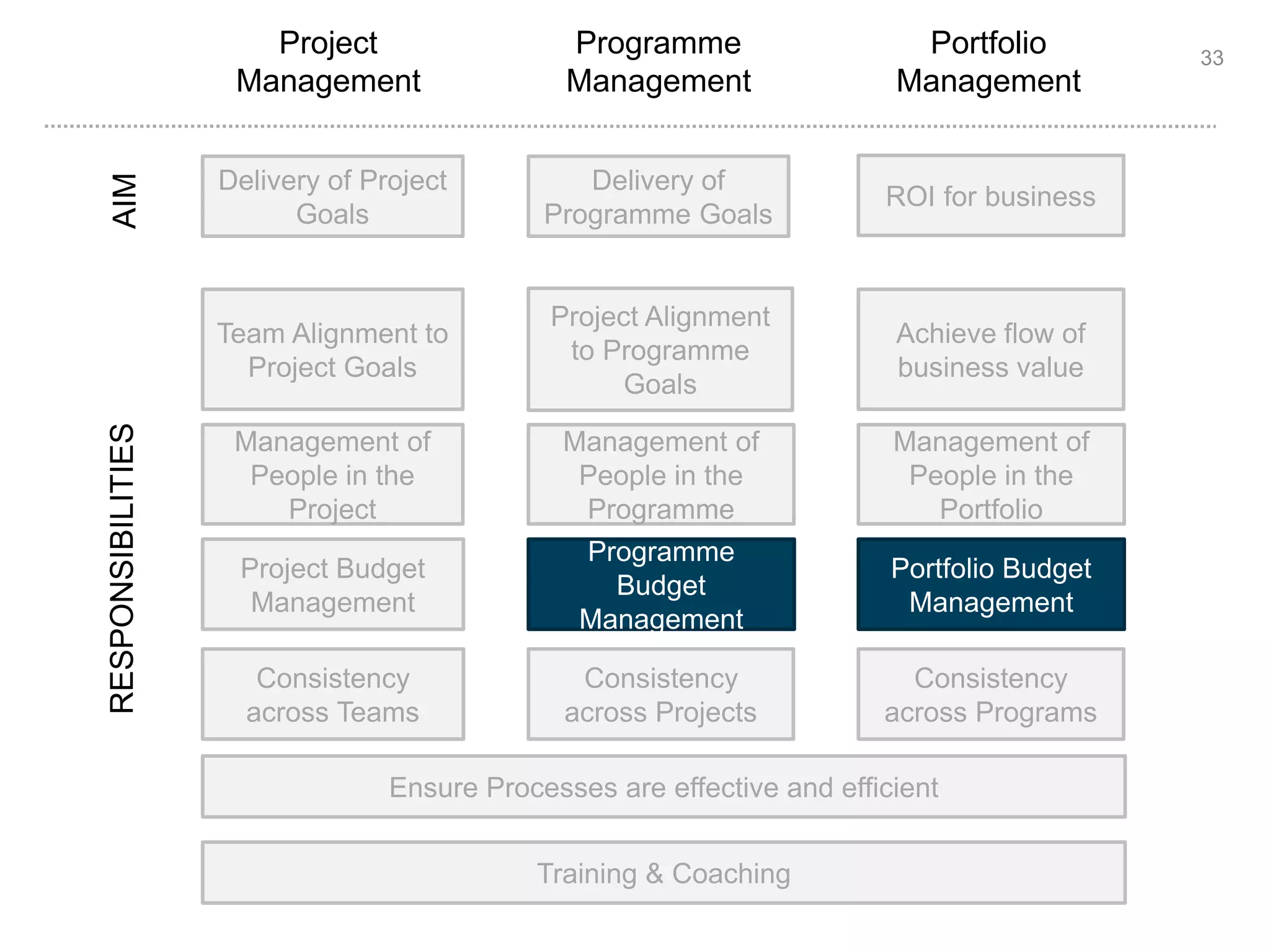

33
RESPONSIBILITIES AIM
Project
Management
Programme
Management
Portfolio
Management
Delivery of Project
Goals
Delivery of
Programme Goals
ROI for business
Team Alignment to
Project Goals
Project Alignment
to Programme
Goals
Achieve flow of
business value
Management of
People in the
Portfolio
Portfolio Budget
Management
Consistency
across Programs
Management of
People in the
Programme
Management of
People in the
Project
Consistency
across Projects
Consistency
across Teams
Programme
Budget
Management
Project Budget
Management
Ensure Processes are effective and efficient
Training & Coaching
Incremental Funding 34
Move towards incremental funding.
Projects are Started/Stop (hence funded or not) at Period Planning
Links to:
• Continuous Flow of value
• Validated Learning
• Tighter build, measure, learn loops
• Smaller projects
The remainder
36
RESPONSIBILITIES AIM
Project
Management
Programme
Management
Portfolio
Management
Delivery of Project
Goals
Delivery of
Programme Goals
ROI for business
Team Alignment to
Project Goals
Project Alignment
to Programme
Goals
Achieve flow of
business value
Management of
People in the
Portfolio
Portfolio Budget
Management
Consistency
across Programs
Management of
People in the
Programme
Management of
People in the
Project
Consistency
across Projects
Consistency
across Teams
Programme
Budget
Management
Project Budget
Management
Ensure Processes are effective and efficient
Training & Coaching
Consistency 37
Consistency is needed across Process, Tools, Metrics
Aim for bare minimum of rules
Teams need freedom to innovate and deliver
Process efficiency and effectiveness 38
Apply Lean thinking
• Eliminate Waste
• Build Quality In
• Create Knowledge
• Defer Commitment
• Deliver Fast
• Respect People
• Optimise The Whole
Apply Agile values
• Individuals and Interactions over
Processes and Tools
• Working Software over
Comprehensive Documentation
• Customer Collaboration over
Contract Negotiation
• Responding to Change over
Following the Plan
Continuously improve.
Don’t accept the status quo.
Training and Coaching 39
Training on
• Processes, Tools, Reporting, etc.
• Agile, Lean, etc.
Coaching on
• Agile, Lean
• Agile Project Management
• Validate Learning, Lean Start Up, Business Model Canvas
• etc.

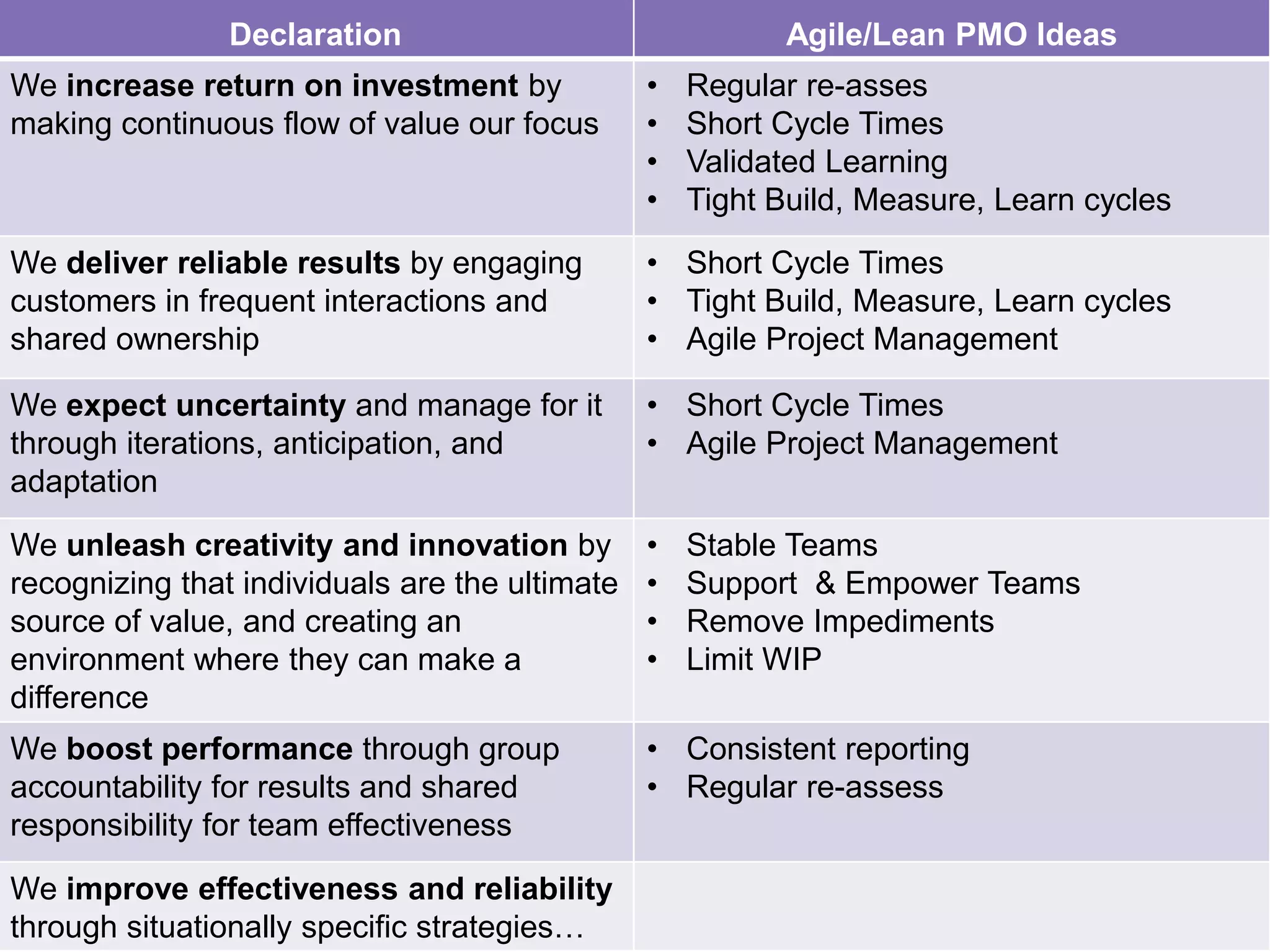

Declaration of
Interdependence
Declaration Agile/Lean PMO Ideas
We increase return on investment by
making continuous flow of value our focus
• Regular re-asses
• Short Cycle Times
• Validated Learning
• Tight Build, Measure, Learn cycles
We deliver reliable results by engaging
customers in frequent interactions and
shared ownership
• Short Cycle Times
• Tight Build, Measure, Learn cycles
• Agile Project Management
We expect uncertainty and manage for it
through iterations, anticipation, and
adaptation
• Short Cycle Times
• Agile Project Management
We unleash creativity and innovation by
recognizing that individuals are the ultimate
source of value, and creating an
environment where they can make a
difference
• Stable Teams
• Support & Empower Teams
• Remove Impediments
• Limit WIP
We boost performance through group
accountability for results and shared
responsibility for team effectiveness
• Consistent reporting
• Regular re-assess
We improve effectiveness and reliability
through situationally specific strategies…
Wrap up
Reference Information
• The agile PMO by cPrime
• Elements of a Lean PMO
• Scaling Agile through Adaptive Governance by Sanjiv Augustine
• The Roles of the Project Management Office in Scrum by Mike Cohn
• 21st Century Portfolio Management by David Joyce
• The Agile PMO by Alex Adamopoulos (Emergn)
43
44
Thank you

Agile & Lean PMO

  • 1.
    Agile/Lean PMO AndrewRusling Agile Coach @andrewrusling
  • 2.
    Competencies to begained By the end of this session, I am hopeful that you will be able to: 1. Summarise the responsibilities of a typical PMO that are impacted by supporting Agile projects. 2. Summarise the Portfolio Management responsibilities that are impacted by supporting Agile projects. 3. Summarise the incremental funding approach 4. Summarise how Lean Portfolio Management achieves flow of value. 5. List the pros and cons of Stable teams vs Dynamic teams. 6. List some strategies that support Stable teams. 2
  • 3.
  • 4.
    Definitions 4 “Anorganizational body or entity assigned various responsibilities related to the centralized and coordinated management of those projects under its domain. The responsibilities of the PMO can range from providing project management support functions to actually being responsible for the direct management of a project.” PMBOK 2003 “A project management office is a formal, centralized layer of control between senior management and project management” IS Project Management: Size, practices and the project management office. 2007
  • 5.
    5 RESPONSIBILITIES AIM Project Management Programme Management Portfolio Management Delivery of Project Goals Delivery of Programme Goals ROI for business Team Alignment to Project Goals Project Alignment to Programme Goals Programme Alignment to Business Strategy People Allocated to Programmes Portfolio Budget Management Consistency across Programs People Allocated to Projects People Allocated to Teams Programme Budget Management Consistency across Projects Project Budget Management Consistency across Teams Ensure Processes are effective and efficient Training & Coaching
  • 6.
  • 7.
    7 RESPONSIBILITIES AIM Project Management Programme Management Portfolio Management Delivery of Project Goals Delivery of Programme Goals ROI for business Team Alignment to Project Goals Project Alignment to Programme Goals Programme Alignment to Business Strategy People Allocated to Programmes Portfolio Budget Management Covered by Agile Project Management Training Consistency across Programs People Allocated to Projects People Allocated to Teams Consistency across Projects Consistency across Teams Programme Budget Management Project Budget Management Ensure Processes are effective and efficient Training & Coaching Limited change
  • 8.
  • 9.
    9 RESPONSIBILITIES AIM Project Management Programme Management Portfolio Management Delivery of Project Goals Delivery of Programme Goals ROI for business Team Alignment to Project Goals Project Alignment to Programme Goals Programme Alignment to Business Strategy People Allocated to Programmes Portfolio Budget Management Consistency across Programs People Allocated to Projects People Allocated to Teams Consistency across Projects Consistency across Teams Programme Budget Management Project Budget Management YES, and ? Ensure Processes are effective and efficient Training & Coaching
  • 10.
    10 RESPONSIBILITIES AIM Project Management Programme Management Portfolio Management Delivery of Project Goals Delivery of Programme Goals ROI for business Team Alignment to Project Goals Project Alignment to Programme Goals Programme Alignment to Business Strategy Management of People in the Portfolio Portfolio Budget Management Consistency across Programs Management of People in the Programme Management of People in the Project Consistency across Projects Consistency across Teams Programme Budget Management Project Budget Management Ensure Processes are effective and efficient Training & Coaching
  • 11.
    People Management 11 Project Management Programme Management Portfolio Management Management of People in the Portfolio Management of People in the Programme Management of People in the Project Move towards Stable Teams Support and empower teams Support and empower teams Remove escalated impediments Remove escalated impediments Remove team impediments Ensure appropriate team & expert allocation to programmes Ensure appropriate team & expert allocation to projects Ensure appropriate expert allocation to teams
  • 12.
    Support and EmpowerTeams Support • Care about peoples wellbeing, growth and morale • Remove Impediments 12 Empower teams • Clear goals aligned to business opportunity & company vision (purpose) • Let them self organise, use a pull model for work allocation (autonomy) • Create opportunities for learning and growth (mastery)
  • 13.
    How should westructure ourselves? Pool of all people Business opportunity pipeline
  • 14.
    Business opportunity pipelinePool of all people Initiate projects to match the work Release people & tear down the project • Prioritised by Business Value • Ordered by people availability Project Backlogs Project Teams
  • 15.
    Allocate work toone or more stable teams • Prioritised by Business Value • Ordered by team availability Pool of Experts i.e. DBA, UX, etc. Business opportunity pipeline Stable Teams Allocate & Release experts to teams each sprint Teams Backlogs
  • 16.
    Stable teams vsProject teams (Pros, Cons) 16 Project Teams Stable Teams + People skills match project need + Keep performing teams + Clearer justification for hiring experts +100% allocation of most people + people skill up in business area + accurate prediction of delivery - Partial allocation of many people - Dependencies between teams - High resource management costs - Delays waiting on team availability - Delays waiting of people availability - Project initiation costs - Delays in starting projects
  • 17.
    Why do wechoose Projects over Stable teams 17 Project Teams Stable Teams Focus on high people utilisation Not looking at throughput Easier to second needed people, then get a team to work cross functionally Teams not as cross functional as needed Brings focus to the project goals Teams are poor at focusing, hence working on many things, delivering none It’s the way we have always done it Once initiated, sponsor doesn’t need to baby sit it, to get a result Continual re-evaluation of projects, can stop some projects Easier to prioritise within a project
  • 18.
  • 19.
    19 RESPONSIBILITIES AIM Project Management Programme Management Portfolio Management Delivery of Project Goals Delivery of Programme Goals ROI for business Team Alignment to Project Goals Project Alignment to Programme Goals Programme Alignment to Business Strategy Management of People in the Portfolio Portfolio Budget Management Consistency across Programs Management of People in the Programme Management of People in the Project Consistency across Projects Consistency across Teams Programme Budget Management Project Budget Management YES, and ? Ensure Processes are effective and efficient Training & Coaching
  • 20.
    20 RESPONSIBILITIES AIM Project Management Programme Management Portfolio Management Delivery of Project Goals Delivery of Programme Goals ROI for business Team Alignment to Project Goals Project Alignment to Programme Goals Achieve flow of business value Management of People in the Portfolio Portfolio Budget Management Consistency across Programs Management of People in the Programme Management of People in the Project Consistency across Projects Consistency across Teams Programme Budget Management Project Budget Management Ensure Processes are effective and efficient Training & Coaching
  • 21.
    Portfolio Management 21 Achieve flow of business value Align projects to business strategic goals Short Cycle Time over High Utilisation Split large projects Validated Learning over Business Cases Tighten Build, Measure, Learn cycles Limit Work In Progress Regular re-assess value delivery
  • 22.
    Regularly reassess valuedelivery 22 Period X months Period Planning Inspect & Adapt X weeks Business Value Portfolio Backlog Period Backlog 1. Assess delivery & potential 2. Select projects to Start / Stop 3. Split large projects 4. Allocate Teams and Budget for projects
  • 23.
    Multiple Projects, MultipleTeams 23 Period 2 months Inspect & Adapt 2 weeks Period Backlog Start Continue Period 2 months Inspect & Adapt 2 weeks Period Backlog Continue Period 2 months Inspect & Adapt 2 weeks Period Backlog Start Stop, Start different one Period 2 months Inspect & Adapt 2 weeks Period Backlog Finished, Start another
  • 24.
    Why focus onshort Cycle Time? Little’s Law, for a stable system • It is hard to delivery items faster. • It is easier to work on less items. • Hence reduce WIP to realise value earlier. • High Utilisation, increases WIP, which reduces Cycle Time and hence reduces Delivery Rate  24 Avg. Cycle Time = Work In Progress (WIP) Avg. Delivery Rate
  • 25.
    How do welimit WIP? 25 1. Stop some projects 2. Reduce the projects that Start/Continue Portfolio Backlog Period Backlog Our capacity Period Planning
  • 26.
    How do welimit WIP? 26 Portfolio Backlog Period Backlog Our capacity Period Planning
  • 27.
    Split Large Project This reduces cycle time, which increases throughput 27 Portfolio Backlog Portfolio Backlog
  • 28.
    Validated Learning overBusiness Cases Business Case Validated Learning Reasoning We can predict what will lead to success We are working from assumptions, that must be verified quickly Success Strategy Plan and manage better Learn faster Project Selection Projects with large expected returns Small projects with good learning opportunities 28
  • 29.
    Validated Learning Approach Encourage Validated Learning at all levels • Project • Release • Sprint • Day to day 29 Aim to test assumptions • Plan, Design and Run Scientific Experiments • Business Canvas • Impact Mapping Delivery early, Iterate Frequently • Use narrow vertical slices • Experiments, not marketable products Gain market feedback • Get out of the building • Talk to real users • A/B Testing • Monitor usage metrics
  • 30.
    Tighten Build, Measure,Learn cycles 30 Period 6 months Period 6 months Knowledge of what realises business value Period 6 months
  • 31.
    Tighten Build, Measure,Learn cycles 31 Period 3 months Period 3 months Period 3 months Period 3 months Period 3 months Period 3 months Knowledge of what realises business value
  • 32.
  • 33.
    33 RESPONSIBILITIES AIM Project Management Programme Management Portfolio Management Delivery of Project Goals Delivery of Programme Goals ROI for business Team Alignment to Project Goals Project Alignment to Programme Goals Achieve flow of business value Management of People in the Portfolio Portfolio Budget Management Consistency across Programs Management of People in the Programme Management of People in the Project Consistency across Projects Consistency across Teams Programme Budget Management Project Budget Management Ensure Processes are effective and efficient Training & Coaching
  • 34.
    Incremental Funding 34 Move towards incremental funding. Projects are Started/Stop (hence funded or not) at Period Planning Links to: • Continuous Flow of value • Validated Learning • Tighter build, measure, learn loops • Smaller projects
  • 35.
  • 36.
    36 RESPONSIBILITIES AIM Project Management Programme Management Portfolio Management Delivery of Project Goals Delivery of Programme Goals ROI for business Team Alignment to Project Goals Project Alignment to Programme Goals Achieve flow of business value Management of People in the Portfolio Portfolio Budget Management Consistency across Programs Management of People in the Programme Management of People in the Project Consistency across Projects Consistency across Teams Programme Budget Management Project Budget Management Ensure Processes are effective and efficient Training & Coaching
  • 37.
    Consistency 37 Consistencyis needed across Process, Tools, Metrics Aim for bare minimum of rules Teams need freedom to innovate and deliver
  • 38.
    Process efficiency andeffectiveness 38 Apply Lean thinking • Eliminate Waste • Build Quality In • Create Knowledge • Defer Commitment • Deliver Fast • Respect People • Optimise The Whole Apply Agile values • Individuals and Interactions over Processes and Tools • Working Software over Comprehensive Documentation • Customer Collaboration over Contract Negotiation • Responding to Change over Following the Plan Continuously improve. Don’t accept the status quo.
  • 39.
    Training and Coaching39 Training on • Processes, Tools, Reporting, etc. • Agile, Lean, etc. Coaching on • Agile, Lean • Agile Project Management • Validate Learning, Lean Start Up, Business Model Canvas • etc.
  • 40.
  • 41.
    Declaration Agile/Lean PMOIdeas We increase return on investment by making continuous flow of value our focus • Regular re-asses • Short Cycle Times • Validated Learning • Tight Build, Measure, Learn cycles We deliver reliable results by engaging customers in frequent interactions and shared ownership • Short Cycle Times • Tight Build, Measure, Learn cycles • Agile Project Management We expect uncertainty and manage for it through iterations, anticipation, and adaptation • Short Cycle Times • Agile Project Management We unleash creativity and innovation by recognizing that individuals are the ultimate source of value, and creating an environment where they can make a difference • Stable Teams • Support & Empower Teams • Remove Impediments • Limit WIP We boost performance through group accountability for results and shared responsibility for team effectiveness • Consistent reporting • Regular re-assess We improve effectiveness and reliability through situationally specific strategies…
  • 42.
  • 43.
    Reference Information •The agile PMO by cPrime • Elements of a Lean PMO • Scaling Agile through Adaptive Governance by Sanjiv Augustine • The Roles of the Project Management Office in Scrum by Mike Cohn • 21st Century Portfolio Management by David Joyce • The Agile PMO by Alex Adamopoulos (Emergn) 43
  • 44.

Editor's Notes

  • #12 Support care about peoples wellbeing, growth and morale Empower teams clear goals aligned to business opportunity & company vision (purpose) Let them self organise, use a pull model for work allocation (autonomy) Create opportunities for learning and growth (mastery)
  • #39 Optimise the Whole - (they are in a unique position to do this)
