helpdesk@construction-productivity.co.uk
htt://www.construction-productivity.co.uk
PROJECT
MANAGEMENT &
BUSINESS PLANNING
PROCESS

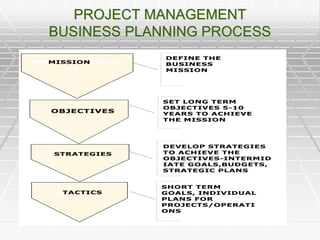

PROJECT MANAGEMENT
BUSINESS PLANNING PROCESS

Organisations under take
RISK when they need to
achieve their business
objectives more effectively.
Expand ONLY when the
potential benefits out weight
the risk involved.
PROJECT MANAGEMENT
BUSINESS PLANNING PROCESS
 All projects should therefore
arise from a need to fulfil two
main factors such as:
1. Specific Strategic Objectives
2. Achieve competitive advantages
PROJECT MANAGEMENT
BUSINESS PLANNING PROCESS
The business planning process has
four essential steps:
Remember ‘MOST’
Mission Statement
 States the reason for the
organisations existence;
 Initiates the business planning
process;
PROJECT MANAGEMENT
BUSINESS PLANNING PROCESS
Objectives are:
 The position;
 In quantities terms;
 In qualitative terms;
 that the organisation wishes to reach;
 Must be in a stated period of time.
PROJECT MANAGEMENT
BUSINESS PLANNING PROCESS

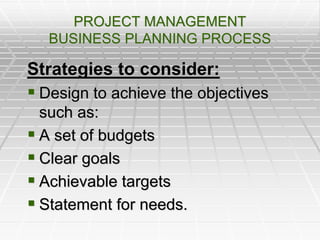

Strategies to consider:
 Design to achieve the objectives
such as:
 A set of budgets
 Clear goals
 Achievable targets
 Statement for needs.
PROJECT MANAGEMENT
BUSINESS PLANNING PROCESS
Covering all aspects of the business
such as:
 People
 Premises
 Organisations
 Capital
 Cash.
PROJECT MANAGEMENT
BUSINESS PLANNING PROCESS
Tactical plans
Individual plans to achieve items such as:
 Defined goal
 Operations and Projects
The plan describes how the organisation
will achieve each element of the strategic
plan.

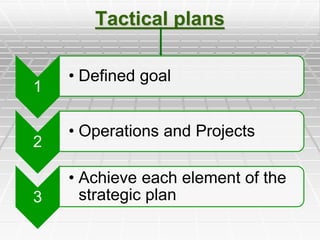

Tactical plans
1
• Defined goal
2
• Operations and Projects
3
• Achieve each element of the
strategic plan
PROJECT MANAGEMENT
BUSINESS PLANNING PROCESS
PROJECT MANAGEMENT
BUSINESS PLANNING PROCESS
Another way to look at Business plan
 Remember ‘COST’
 C Commitment by all concerned to the project
 O Objectives being clear to all-Scope and
Mission
 S Strategy to meet the objectives-Milestone
Plan
 T Tactical-activities found necessary to
achieve to each milestone and solve Problems
P7
FUNCTION OF PROJECT MANAGEMENT
FUNCTION OF MANAGEMENT TEAM
 The basic Management Principles
described by Henri Fayol are:
 To plan
 To organise
 To co-ordinate
 To control
 To lead

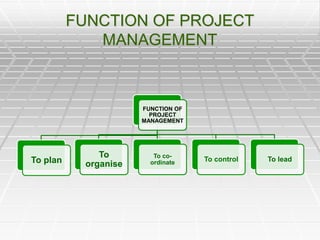

FUNCTION OF PROJECT
MANAGEMENT
FUNCTION OF
PROJECT
MANAGEMENT
To leadTo controlTo co-
ordinate
To
organiseTo plan
FUNCTION OF PROJECT MANAGEMENT

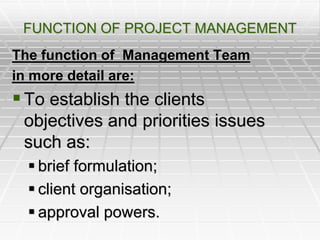

The function of Management Team
in more detail are:
To establish the clients
objectives and priorities issues
such as:
 brief formulation;
 client organisation;
 approval powers.
FUNCTION OF PROJECT MANAGEMENT
Design Project Organisation
Such as:
 organisation chart;
 decision point;
 Relationships;
 feed back.
FUNCTION OF PROJECT MANAGEMENT
Integrate Client into the
project
client organisation
integrated into project
organisation;
people responsibilities;
decision processes.
FUNCTION OF PROJECT MANAGEMENT
Selection and appointment of
Contributors
 identify contributors;
 identify input required;
 identify when input required and
duration;
 record types of appointment.
FUNCTION OF PROJECT MANAGEMENT
Full brief formulation process
 Establish need, budget, cost
plan, cost limit, procurement
route.
 Start value engineering.
 Programme formulation.
 The overall project programme.
FUNCTION OF PROJECT MANAGEMENT
The phase or stage programme
The design programme.
The procurement programme.
The construction programme.
The commissioning
programme.
FUNCTION OF PROJECT MANAGEMENT
Activation of the relationships
between contributors
 Ensure contributors are brought
in and integrated into the project
organisation.
 Ensure contributors can perform
as required.
FUNCTION OF PROJECT MANAGEMENT
Establish appropriate information
and communication structure by:
 establishing a full project
procedures manual containing;
 description of formal
communication cannel;
FUNCTION OF PROJECT MANAGEMENT

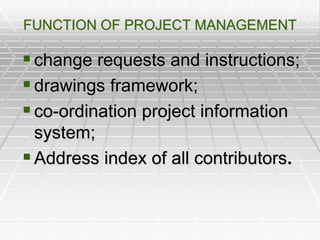

change requests and instructions;
drawings framework;
co-ordination project information
system;
Address index of all contributors.
FUNCTION OF PROJECT MANAGEMENT

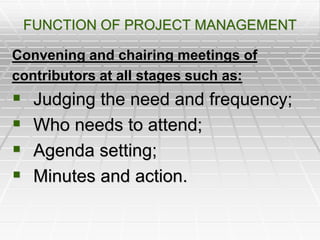

Convening and chairing meetings of
contributors at all stages such as:
 Judging the need and frequency;
 Who needs to attend;
 Agenda setting;
 Minutes and action.
FUNCTION OF PROJECT MANAGEMENT
Monitoring and controlling
 Pro-active role;
 Obtaining feedback and under taking
analysis;
 Testing outcomes to objectives and
taking corrective action;
 Forecasting;
 Integrating and controlling contributors.
FUNCTION OF PROJECT MANAGEMENT
Managing completion
 Commissioning programme;
 Training of user;
 As built drawings-user maintenance
manuals;
 Strategy for occupation or disposal.
Evaluation of outcomes
 Success in achieving objectives;
 The final feedback loop;
FUNCTION OF PROJECT MANAGEMENT
SYSTEMATIC APPROACH TO ANY
PROJECT
 Royal Institute of British Architects
(RIBA PLAN OF WORK)

TACTICAL PLANS
M is s io n 5
y e a r s
o b je c tiv e s
S tr a te g ie s
T a c tic a l
p la n s
T a c tic a l
le v e l(a c tiv itie s )
S tr a te g ic le v e l
( m ile s to n e s )
I n te g r a tiv e
le v e l
( p u r p o s e a n d
o b je c tiv e s
R E L A T I O N S H I P B E T W E E N C O R P O R A T E P L A N A N D P R O J E C T P L A N
P r o je c t M is s io n , S c o p e , O r g a n iz a tio n
M ile s to n e s
E v e n t o rie n ta te d
A c tiv it y o rie n t a te d
RIBA PLAN OF WORK
Appraisal
1 Carry out studies to determine the
feasibility of the Client's requirement.
2 2A Review with client alternative design
and construction approaches and the
cost Implications.
3 2B Provide information for report on cost
implications.
RIBA PLAN OF WORK
B Strategic Brief
1 Receive strategic brief prepared by the client.
C Outline Proposals
1 Commence development of Strategic Brief into
Project Brief
2 Prepare Outline Proposal
3A Provide an approximation of construction
costs. OR
3B Provide information for cost planning.
RIBA PLAN OF WORK
 4 Obtain Client approval to Outline
Proposals and approximate construction
cost.
 5 Co-operate with Planning Supervisor
where applicable.
RIBA PLAN OF WORK
D Detailed Proposals
1 Complete developments of Project Brief.
2 Develop the Detailed Proposal from
approved Outline Proposals.
3A Prepare a cost estimate. OR
3B Provide information for preparation of
cost estimate.
4 Consult statutory authorities.
RIBA PLAN OF WORK

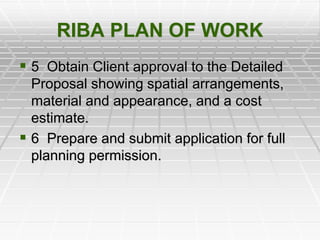

 5 Obtain Client approval to the Detailed
Proposal showing spatial arrangements,
material and appearance, and a cost
estimate.
 6 Prepare and submit application for full
planning permission.
RIBA PLAN OF WORK
E Final Proposals
 1 Design Final Proposals from approved
Detailed Proposals.
 2A Revise cost estimate.
 2B Provide information for revision of cost
estimate.
 3 Consult statutory authorities on
developed design proposals.
RIBA PLAN OF WORK
 4 Obtain Client approval to type of
construction, quality of materials, standard
of workmanship and revised cost
estimate.
 5 Advise on consequences of any
subsequent changes on cost and
programme.
RIBA PLAN OF WORK
F Production Information
1 Prepare production information for tender
purposes.
2A Prepare schedules of rates and/or
quantities and/or schedules of works for
tendering purposes and revise cost
estimate. OR
RIBA PLAN OF WORK
 2B Provide information for preparation of
tender pricing documents and revision of
cost estimate.
 3A Prepare and make submissions under
building acts and/or regulations for other
statutory requirements. OR
 3B Prepare and give building notice under
building acts and/or regulations (not
applicable in Scotland).
RIBA PLAN OF WORK
 4 Prepare further production information
for construction purposes.
G Tender documents
1 Prepare and collate tender documents in
sufficient detail to enable a tender or
tenders to be obtained.
2 Where applicable pass final information
to Planning Supervisor for pre-tender
Health and Safety Plan.
RIBA PLAN OF WORK
 3A Prepare pre-tender costs. OR
 3B Provide information for preparation of
pre-tender cost estimate
H Tender Action
1 Contribute to appraisal and report on
tenders negotiations.
2 If instructed revise production information
to meet adjustments in the tender sum.
RIBA PLAN OF WORK
J Mobilisation
1 Provide production information as
requested for the building contract and for
construction.
K Construction to Practical Completion
1 Make visits to the works in connection
with the Architect's design.
RIBA PLAN OF WORK

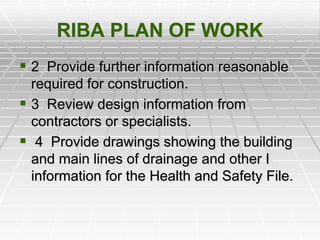

 2 Provide further information reasonable
required for construction.
 3 Review design information from
contractors or specialists.
 4 Provide drawings showing the building
and main lines of drainage and other I
information for the Health and Safety File.
RIBA PLAN OF WORK
 5 Give general advice on operation and
maintenance of the building.
L After Practical Completion.
1 Identify defects and make final
inspections.
2A Settle Final Account. OR
2B Provide information required by others
for settling final account.

012 bussiness planning process

  • 1.
  • 2.
    PROJECT MANAGEMENT BUSINESS PLANNINGPROCESS Organisations under take RISK when they need to achieve their business objectives more effectively. Expand ONLY when the potential benefits out weight the risk involved.
  • 3.
    PROJECT MANAGEMENT BUSINESS PLANNINGPROCESS  All projects should therefore arise from a need to fulfil two main factors such as: 1. Specific Strategic Objectives 2. Achieve competitive advantages
  • 4.
    PROJECT MANAGEMENT BUSINESS PLANNINGPROCESS The business planning process has four essential steps: Remember ‘MOST’ Mission Statement  States the reason for the organisations existence;  Initiates the business planning process;
  • 5.
    PROJECT MANAGEMENT BUSINESS PLANNINGPROCESS Objectives are:  The position;  In quantities terms;  In qualitative terms;  that the organisation wishes to reach;  Must be in a stated period of time.
  • 6.
    PROJECT MANAGEMENT BUSINESS PLANNINGPROCESS Strategies to consider:  Design to achieve the objectives such as:  A set of budgets  Clear goals  Achievable targets  Statement for needs.
  • 7.
    PROJECT MANAGEMENT BUSINESS PLANNINGPROCESS Covering all aspects of the business such as:  People  Premises  Organisations  Capital  Cash.
  • 8.
    PROJECT MANAGEMENT BUSINESS PLANNINGPROCESS Tactical plans Individual plans to achieve items such as:  Defined goal  Operations and Projects The plan describes how the organisation will achieve each element of the strategic plan.
  • 9.
    Tactical plans 1 • Definedgoal 2 • Operations and Projects 3 • Achieve each element of the strategic plan
  • 10.
  • 11.
    PROJECT MANAGEMENT BUSINESS PLANNINGPROCESS Another way to look at Business plan  Remember ‘COST’  C Commitment by all concerned to the project  O Objectives being clear to all-Scope and Mission  S Strategy to meet the objectives-Milestone Plan  T Tactical-activities found necessary to achieve to each milestone and solve Problems
  • 14.
  • 15.
    FUNCTION OF PROJECTMANAGEMENT FUNCTION OF MANAGEMENT TEAM  The basic Management Principles described by Henri Fayol are:  To plan  To organise  To co-ordinate  To control  To lead
  • 16.
    FUNCTION OF PROJECT MANAGEMENT FUNCTIONOF PROJECT MANAGEMENT To leadTo controlTo co- ordinate To organiseTo plan
  • 17.
    FUNCTION OF PROJECTMANAGEMENT The function of Management Team in more detail are: To establish the clients objectives and priorities issues such as:  brief formulation;  client organisation;  approval powers.
  • 18.
    FUNCTION OF PROJECTMANAGEMENT Design Project Organisation Such as:  organisation chart;  decision point;  Relationships;  feed back.
  • 19.
    FUNCTION OF PROJECTMANAGEMENT Integrate Client into the project client organisation integrated into project organisation; people responsibilities; decision processes.
  • 20.
    FUNCTION OF PROJECTMANAGEMENT Selection and appointment of Contributors  identify contributors;  identify input required;  identify when input required and duration;  record types of appointment.
  • 21.
    FUNCTION OF PROJECTMANAGEMENT Full brief formulation process  Establish need, budget, cost plan, cost limit, procurement route.  Start value engineering.  Programme formulation.  The overall project programme.
  • 22.
    FUNCTION OF PROJECTMANAGEMENT The phase or stage programme The design programme. The procurement programme. The construction programme. The commissioning programme.
  • 23.
    FUNCTION OF PROJECTMANAGEMENT Activation of the relationships between contributors  Ensure contributors are brought in and integrated into the project organisation.  Ensure contributors can perform as required.
  • 24.
    FUNCTION OF PROJECTMANAGEMENT Establish appropriate information and communication structure by:  establishing a full project procedures manual containing;  description of formal communication cannel;
  • 25.
    FUNCTION OF PROJECTMANAGEMENT change requests and instructions; drawings framework; co-ordination project information system; Address index of all contributors.
  • 26.
    FUNCTION OF PROJECTMANAGEMENT Convening and chairing meetings of contributors at all stages such as:  Judging the need and frequency;  Who needs to attend;  Agenda setting;  Minutes and action.
  • 27.
    FUNCTION OF PROJECTMANAGEMENT Monitoring and controlling  Pro-active role;  Obtaining feedback and under taking analysis;  Testing outcomes to objectives and taking corrective action;  Forecasting;  Integrating and controlling contributors.
  • 28.
    FUNCTION OF PROJECTMANAGEMENT Managing completion  Commissioning programme;  Training of user;  As built drawings-user maintenance manuals;  Strategy for occupation or disposal. Evaluation of outcomes  Success in achieving objectives;  The final feedback loop;
  • 29.
    FUNCTION OF PROJECTMANAGEMENT SYSTEMATIC APPROACH TO ANY PROJECT  Royal Institute of British Architects (RIBA PLAN OF WORK)
  • 30.
    TACTICAL PLANS M iss io n 5 y e a r s o b je c tiv e s S tr a te g ie s T a c tic a l p la n s T a c tic a l le v e l(a c tiv itie s ) S tr a te g ic le v e l ( m ile s to n e s ) I n te g r a tiv e le v e l ( p u r p o s e a n d o b je c tiv e s R E L A T I O N S H I P B E T W E E N C O R P O R A T E P L A N A N D P R O J E C T P L A N P r o je c t M is s io n , S c o p e , O r g a n iz a tio n M ile s to n e s E v e n t o rie n ta te d A c tiv it y o rie n t a te d
  • 31.
    RIBA PLAN OFWORK Appraisal 1 Carry out studies to determine the feasibility of the Client's requirement. 2 2A Review with client alternative design and construction approaches and the cost Implications. 3 2B Provide information for report on cost implications.
  • 32.
    RIBA PLAN OFWORK B Strategic Brief 1 Receive strategic brief prepared by the client. C Outline Proposals 1 Commence development of Strategic Brief into Project Brief 2 Prepare Outline Proposal 3A Provide an approximation of construction costs. OR 3B Provide information for cost planning.
  • 33.
    RIBA PLAN OFWORK  4 Obtain Client approval to Outline Proposals and approximate construction cost.  5 Co-operate with Planning Supervisor where applicable.
  • 34.
    RIBA PLAN OFWORK D Detailed Proposals 1 Complete developments of Project Brief. 2 Develop the Detailed Proposal from approved Outline Proposals. 3A Prepare a cost estimate. OR 3B Provide information for preparation of cost estimate. 4 Consult statutory authorities.
  • 35.
    RIBA PLAN OFWORK  5 Obtain Client approval to the Detailed Proposal showing spatial arrangements, material and appearance, and a cost estimate.  6 Prepare and submit application for full planning permission.
  • 36.
    RIBA PLAN OFWORK E Final Proposals  1 Design Final Proposals from approved Detailed Proposals.  2A Revise cost estimate.  2B Provide information for revision of cost estimate.  3 Consult statutory authorities on developed design proposals.
  • 37.
    RIBA PLAN OFWORK  4 Obtain Client approval to type of construction, quality of materials, standard of workmanship and revised cost estimate.  5 Advise on consequences of any subsequent changes on cost and programme.
  • 38.
    RIBA PLAN OFWORK F Production Information 1 Prepare production information for tender purposes. 2A Prepare schedules of rates and/or quantities and/or schedules of works for tendering purposes and revise cost estimate. OR
  • 39.
    RIBA PLAN OFWORK  2B Provide information for preparation of tender pricing documents and revision of cost estimate.  3A Prepare and make submissions under building acts and/or regulations for other statutory requirements. OR  3B Prepare and give building notice under building acts and/or regulations (not applicable in Scotland).
  • 40.
    RIBA PLAN OFWORK  4 Prepare further production information for construction purposes. G Tender documents 1 Prepare and collate tender documents in sufficient detail to enable a tender or tenders to be obtained. 2 Where applicable pass final information to Planning Supervisor for pre-tender Health and Safety Plan.
  • 41.
    RIBA PLAN OFWORK  3A Prepare pre-tender costs. OR  3B Provide information for preparation of pre-tender cost estimate H Tender Action 1 Contribute to appraisal and report on tenders negotiations. 2 If instructed revise production information to meet adjustments in the tender sum.
  • 42.
    RIBA PLAN OFWORK J Mobilisation 1 Provide production information as requested for the building contract and for construction. K Construction to Practical Completion 1 Make visits to the works in connection with the Architect's design.
  • 43.
    RIBA PLAN OFWORK  2 Provide further information reasonable required for construction.  3 Review design information from contractors or specialists.  4 Provide drawings showing the building and main lines of drainage and other I information for the Health and Safety File.
  • 44.
    RIBA PLAN OFWORK  5 Give general advice on operation and maintenance of the building. L After Practical Completion. 1 Identify defects and make final inspections. 2A Settle Final Account. OR 2B Provide information required by others for settling final account.
