Effort distribution, be it by phase or activity, is an important aspect of SDLC. Yet it is often overlooked in
the process of cost estimation. Poor effort allocation is one of the root causes of rework owing to early activities
being insufficiently resourced. This paper presents various phase effort distribution patterns and variation sources.
The analysis results of these patterns show some consistency in effects of size of software and team size on code
and test phase distribution variations, and some considerable deviations in design, requirements, and transition
phases, compared with recommendations in the COCOMO model. Software size, in turn, depends on the smallmedium,
medium-large companies having different schemes. Finally, the major findings of this paper discusses
about threats to validity and presents general guidelines in directing effort distribution across the various software
development methods, time duration of the phases of SDLC and the team strength. Based on the above factors,
effort distribution can be estimated.
NCV 3 Project Management Hands-On Support Slide Show - Module 1Future Managers
This slide show complements the learner guide NCV 3 Project Management Hands-On Training by Bert Eksteen published by Future Managers Pty Ltd. For more information visit our website www.futuremanagers.net
NCV 3 Project Management Hands-On Support Slide Show - Module 4Future Managers
This slide show complements the learner guide NCV 3 Project Management Hands-On Training by Bert Eksteen published by Future Managers Pty Ltd. For more information visit our website www.futuremanagers.net
Effort distribution, be it by phase or activity, is an important aspect of SDLC. Yet it is often overlooked in
the process of cost estimation. Poor effort allocation is one of the root causes of rework owing to early activities
being insufficiently resourced. This paper presents various phase effort distribution patterns and variation sources.
The analysis results of these patterns show some consistency in effects of size of software and team size on code
and test phase distribution variations, and some considerable deviations in design, requirements, and transition
phases, compared with recommendations in the COCOMO model. Software size, in turn, depends on the smallmedium,
medium-large companies having different schemes. Finally, the major findings of this paper discusses
about threats to validity and presents general guidelines in directing effort distribution across the various software
development methods, time duration of the phases of SDLC and the team strength. Based on the above factors,
effort distribution can be estimated.
NCV 3 Project Management Hands-On Support Slide Show - Module 1Future Managers
This slide show complements the learner guide NCV 3 Project Management Hands-On Training by Bert Eksteen published by Future Managers Pty Ltd. For more information visit our website www.futuremanagers.net
NCV 3 Project Management Hands-On Support Slide Show - Module 4Future Managers
This slide show complements the learner guide NCV 3 Project Management Hands-On Training by Bert Eksteen published by Future Managers Pty Ltd. For more information visit our website www.futuremanagers.net
INCREASING THE ARCHITECTURES DESIGN QUALITY FOR MAS: AN APPROACH TO MINIMIZE ...cscpconf
The efficiency of multi agent system design mainly relies on the quality of a conceptual architecture of such systems. Hence, quality issues should be considered at an early stage in the software development process. Large systems such as multi agents systems (MAS) require many communications and interactions to fulfil their tasks, and this leads to complexity of architecture design (AD) which have crucial influence on architecture design quality. This work attempts to introduce approach to increase the architecture design quality of MAS by minimizing the effect of complexity.
Information system project management (IT - project) is a complex iterative process. An important role for the development of complex IT projects plays records of the development lifecycle (LC). The article presents an analysis of the effectiveness of the work on the creation of IT - projects based on two modified models of the life cycle: cascade and spiral. Analysis of the effectiveness of the management of the IT project was implemented on the basis of simulation. The modeling was carried out on the basis of Any Ljgic tools on the example of development of geoinformation system (GIS). It is shown that it is advisable to design GIS on the basis of a modified spiral LC with splitting of the flow of requirements at the input. The peculiarity of the proposed study is to take into account the requirements in the form of communicative interactions of different types. Under the communicative interactions are understood all the interactions between the subjects of the process of creating an IT-project: verbal and non - verbal, carried out on the basis of CASE-means
PT communication
Science, Politics,Scholarly Articles For Mathematics and Productivity, Religion
http://www.twitlonger.com/show/n_1sphfcg?new_post=true …
Communications Management PlanProject NameTable of Contents.docxclarebernice
Communications Management Plan
<Project Name>
Table of Contents
2Introduction
2Communications Management Approach
3Communications Management Constraints
3Stakeholder Communication Requirements
4Roles
6Project Team Directory
6Communication Methods and Technologies
8Communications Matrix
9Communication Flowchart
9Guidelines for Meetings
10Communication Standards
11Communication Escalation Process
12Glossary of Communication Terminology
Introduction
The purpose of the Communications Management Plan is to define the communication requirements for the project and how information will be distributed. The Communications Management Plan defines the following:
· What information will be communicated—to include the level of detail and format
· How the information will be communicated—in meetings, email, telephone, web portal, etc.
· When information will be distributed—the frequency of project communications both formal and informal
· Who is responsible for communicating project information
· Communication requirements for all project stakeholders
· What resources the project allocates for communication
· How any sensitive or confidential information is communicated and who must authorize this
· How changes in communication or the communication process are managed
· The flow of project communications
· Any constraints, internal or external, which affect project communications
· Any standard templates, formats, or documents the project must use for communicating
· An escalation process for resolving any communication-based conflicts or issuesCommunications Management Approach
Approximately 80% of a Project Manager’s time is spent communicating. Think about it – as a Project Manager you are spending most of your time measuring and reporting on the performance of the project, composing and reading emails, conducting meetings, writing the project plan, meeting with team members, overseeing work being performed, meeting with clients over lunch and many more activities related to your projects.
You should give considerable thought to how you want to manage communications on this project. By having a solid communications management approach you’ll find that many project management problems can be avoided. In this section give an overview of your communications management approach.Communications Management Constraints
All projects are subject to limitations and constraints as they must be within scope and adhere to budget, scheduling, and resource requirements. Project planning and documentation are no exception to this rule. There may also be legislative, regulatory, technology, or organizational policy requirements which must be followed as part of communications management. These constraints must be clearly understood and communicated to all stakeholders. While communications management is arguably one of the most important aspects of project management, it must be done in an effective manner and within the constraints of the allocated budget, ...
Testudaan is Best PMP Exam Simulator which have knowledge area wise mini tests and PMP Simulated Tests. one of the ppt of communication management PPT is there which help you to real Exam.
I have tried to put in a small presentation to highlight the importance of communication giving success to effective project management thereby enable all stakeholders informed on RAID to critical path activities to scope creep. As I was involved in many IT and other PM activities I felt lack of clear communication is causing many projects/programs going into code-red. Your views are always welcome. All views are my personal ones
TaskNetworking Systems Administration StudentsTaskBased on y.docxjohniemcm5zt
Task
Networking / Systems Administration Students
Task
Based on your specific project charter and management plan you will have an agreement with your client about the functionality available and demonstrable at this point in the project. Your project will be assessed on having achieved these agreed goals. You will also be assessed on the quality of visual and verbal communication in your presentation including a clear statement regarding
For students completing the Globex project, functionality that must be demonstrated at this point is:
Wagga – demonstrate logs can be securely collected / retrieved for a 2 hour period (obviously you will have to pause your recording while the actual collection occurs, this is fine) from all network devices on the local site and at least one remote site
Albury – demonstrate that an end user at another physical site is able to download a virus test file from http://www.eicar.org/download/eicar.com and that this action results in a secure alert being generated by the IDS
Griffith – demonstrate that at least one other server from an external site can be taken offline (simulating a disaster) and fully recovered in a secure manner to an alternative site meeting RTO/RPO objectives.
Cloud – demonstrate an encrypted VoIP conversation can occur between two sites using soft phones.
Submission instructions:
record a short screencast or video and upload to Youtube or Vimeo. You may submit as a group (with a single 10-12 minute recording) or individually (2-3 minute recording). All students will be marked individually. A link to your recording should be submitted to EASTS.
Business Analysis / IT Management Students
Word count:
2000 words. This does not include MS Project file, tables, calculations, references or appendices.
Task
There are four elements to this assessment.
1.
You are to provide a detailed status update report for the project’s budget and schedule to demonstrate the monitoring and controlling of the project. Utilising MS Project, you must demonstrate actual vs planned work and any variances, as well as a plan to ensure the remainder of the project meets agreed milestones.
2.
Calculate the project’s earned value (see reading – Kloppenborg ) and discuss how this affects your project.
3.
Develop a form to capture the lessons learned from this project, to be completed by all project team members
4.
Globex is looking to outsource some software development work and are seeking advice on the most appropriate type of contract to use in terms of risk to the company. In 1000 words compare and contrast available contract types and recommend the most suitable for Globex to use in this scenario.
Rationale
This assessment item is designed to assess your progress towards the following learning outcomes and writing skills
Networking / Systems Administration Students
Learning outcomes
:
Be able to implement standard testing parameters and evaluate system performance.
Business Analysis / IT Management .
INCREASING THE ARCHITECTURES DESIGN QUALITY FOR MAS: AN APPROACH TO MINIMIZE ...cscpconf
The efficiency of multi agent system design mainly relies on the quality of a conceptual architecture of such systems. Hence, quality issues should be considered at an early stage in the software development process. Large systems such as multi agents systems (MAS) require many communications and interactions to fulfil their tasks, and this leads to complexity of architecture design (AD) which have crucial influence on architecture design quality. This work attempts to introduce approach to increase the architecture design quality of MAS by minimizing the effect of complexity.
Information system project management (IT - project) is a complex iterative process. An important role for the development of complex IT projects plays records of the development lifecycle (LC). The article presents an analysis of the effectiveness of the work on the creation of IT - projects based on two modified models of the life cycle: cascade and spiral. Analysis of the effectiveness of the management of the IT project was implemented on the basis of simulation. The modeling was carried out on the basis of Any Ljgic tools on the example of development of geoinformation system (GIS). It is shown that it is advisable to design GIS on the basis of a modified spiral LC with splitting of the flow of requirements at the input. The peculiarity of the proposed study is to take into account the requirements in the form of communicative interactions of different types. Under the communicative interactions are understood all the interactions between the subjects of the process of creating an IT-project: verbal and non - verbal, carried out on the basis of CASE-means
PT communication
Science, Politics,Scholarly Articles For Mathematics and Productivity, Religion
http://www.twitlonger.com/show/n_1sphfcg?new_post=true …
Communications Management PlanProject NameTable of Contents.docxclarebernice
Communications Management Plan
<Project Name>
Table of Contents
2Introduction
2Communications Management Approach
3Communications Management Constraints
3Stakeholder Communication Requirements
4Roles
6Project Team Directory
6Communication Methods and Technologies
8Communications Matrix
9Communication Flowchart
9Guidelines for Meetings
10Communication Standards
11Communication Escalation Process
12Glossary of Communication Terminology
Introduction
The purpose of the Communications Management Plan is to define the communication requirements for the project and how information will be distributed. The Communications Management Plan defines the following:
· What information will be communicated—to include the level of detail and format
· How the information will be communicated—in meetings, email, telephone, web portal, etc.
· When information will be distributed—the frequency of project communications both formal and informal
· Who is responsible for communicating project information
· Communication requirements for all project stakeholders
· What resources the project allocates for communication
· How any sensitive or confidential information is communicated and who must authorize this
· How changes in communication or the communication process are managed
· The flow of project communications
· Any constraints, internal or external, which affect project communications
· Any standard templates, formats, or documents the project must use for communicating
· An escalation process for resolving any communication-based conflicts or issuesCommunications Management Approach
Approximately 80% of a Project Manager’s time is spent communicating. Think about it – as a Project Manager you are spending most of your time measuring and reporting on the performance of the project, composing and reading emails, conducting meetings, writing the project plan, meeting with team members, overseeing work being performed, meeting with clients over lunch and many more activities related to your projects.
You should give considerable thought to how you want to manage communications on this project. By having a solid communications management approach you’ll find that many project management problems can be avoided. In this section give an overview of your communications management approach.Communications Management Constraints
All projects are subject to limitations and constraints as they must be within scope and adhere to budget, scheduling, and resource requirements. Project planning and documentation are no exception to this rule. There may also be legislative, regulatory, technology, or organizational policy requirements which must be followed as part of communications management. These constraints must be clearly understood and communicated to all stakeholders. While communications management is arguably one of the most important aspects of project management, it must be done in an effective manner and within the constraints of the allocated budget, ...
Testudaan is Best PMP Exam Simulator which have knowledge area wise mini tests and PMP Simulated Tests. one of the ppt of communication management PPT is there which help you to real Exam.
I have tried to put in a small presentation to highlight the importance of communication giving success to effective project management thereby enable all stakeholders informed on RAID to critical path activities to scope creep. As I was involved in many IT and other PM activities I felt lack of clear communication is causing many projects/programs going into code-red. Your views are always welcome. All views are my personal ones
TaskNetworking Systems Administration StudentsTaskBased on y.docxjohniemcm5zt
Task
Networking / Systems Administration Students
Task
Based on your specific project charter and management plan you will have an agreement with your client about the functionality available and demonstrable at this point in the project. Your project will be assessed on having achieved these agreed goals. You will also be assessed on the quality of visual and verbal communication in your presentation including a clear statement regarding
For students completing the Globex project, functionality that must be demonstrated at this point is:
Wagga – demonstrate logs can be securely collected / retrieved for a 2 hour period (obviously you will have to pause your recording while the actual collection occurs, this is fine) from all network devices on the local site and at least one remote site
Albury – demonstrate that an end user at another physical site is able to download a virus test file from http://www.eicar.org/download/eicar.com and that this action results in a secure alert being generated by the IDS
Griffith – demonstrate that at least one other server from an external site can be taken offline (simulating a disaster) and fully recovered in a secure manner to an alternative site meeting RTO/RPO objectives.
Cloud – demonstrate an encrypted VoIP conversation can occur between two sites using soft phones.
Submission instructions:
record a short screencast or video and upload to Youtube or Vimeo. You may submit as a group (with a single 10-12 minute recording) or individually (2-3 minute recording). All students will be marked individually. A link to your recording should be submitted to EASTS.
Business Analysis / IT Management Students
Word count:
2000 words. This does not include MS Project file, tables, calculations, references or appendices.
Task
There are four elements to this assessment.
1.
You are to provide a detailed status update report for the project’s budget and schedule to demonstrate the monitoring and controlling of the project. Utilising MS Project, you must demonstrate actual vs planned work and any variances, as well as a plan to ensure the remainder of the project meets agreed milestones.
2.
Calculate the project’s earned value (see reading – Kloppenborg ) and discuss how this affects your project.
3.
Develop a form to capture the lessons learned from this project, to be completed by all project team members
4.
Globex is looking to outsource some software development work and are seeking advice on the most appropriate type of contract to use in terms of risk to the company. In 1000 words compare and contrast available contract types and recommend the most suitable for Globex to use in this scenario.
Rationale
This assessment item is designed to assess your progress towards the following learning outcomes and writing skills
Networking / Systems Administration Students
Learning outcomes
:
Be able to implement standard testing parameters and evaluate system performance.
Business Analysis / IT Management .
Lindorff Group is a leading outsourced receivables management company in Europe, and one of the leading on a global basis. For the past three–four years, they have increasingly adopted agile practices, especially in a large scale project converting and improving an old system written in Powerhouse to new .Net–technology.
The results from adopting agile practices have been mostly positive, however, there were challenging issues related to requirement handling and estimation that needed attention. In 2008, Lindorff joined a project with Symphonical funded by Innovation Norway. The purpose of the project was to develop software for requirements handling, estimation and knowledge management for the Symphonical platform. Symphonical is a flexible web–based collaboration platform, where users can brainstorm, plan, organize and coordinate any process.
This talk presents results from a case study detailing the challenges faced by Lindorff as they simultaneously adopted agile practices and introduced a new system for requirement handling and estimation. According to the respondents of the case study, Lindorff appears to have improved on two of the main points of concern presented in the 2007 study: requirement handling and estimation. Many users report that the introduction of agile methods and the platform Symphonical has improved the quality of important work processes. Furthermore, they report that the introduction of Symphonical has provided a framework for structured discussions regarding individual requirements, which helps maintaining the focus of IT projects. Furthermore, the flexible sharing regime where one can easily share information to external participants improves the effectiveness and efficiency of collaboration with all project contributors.
➽=ALL False flag-War Machine-War profiteering-Energy (oil/Gas) Iraq, Iran,…oil and gas
USA invades other countries just to own their natural resources and to place them in the hands of American corporations. Facebook doesn’t call that terrorism. They call it democracy. BBC, CNN, FOX NEWS, FR 24, ITV/CH 4, SKY, EURO NEWS, ITV trash Sun paper,… Facebook all are protector and preserver of the propaganda classifying IR Iran as a dangerous terrorist organization. But FB, BBC, CNN, FOX NEWS, FR 24, ITV/CH 4-SKY, EURO NEWS, ITV do know well, that USA is the biggest terrorist country in the world.
‘terrorism’ the unlawful use of violence and intimidation, especially against civilians, in the pursuit of political aims.
"the fight against terrorism" is the fight against the unlawful use of violence and intimidation and carpet bombing.
Ever since the beginning of the 19th century, the West has been sucking on the jugular vein of the Moslem body politic like a veritable vampire whose thirst for Moslem blood is never sated and who refused to let go. Since 1979, Iran, which has always played the role of the intellectual leader of the Islamic world, has risen up to put a stop to this outrage against God’s law and will, and against all decency.
MY NEWS PUNCH DR F DEJAHANG 28/12/2019
PART 1 (IN TOTAL 12 PARTS)
NEWS YOU WON’T FIND ON BBC-CNN-FOX NEWS, FR 24, EURO NEWS, ITV…
ALL In My Documents: https://www.edocr.com/user/drdejahang02
Also in https://www.edocr.com/v/jqmplrpj/drdejahang02/LINKS-08-12-2019-PROJECT-ONE Click on Social Websites of mine >60
Articles for Political Science, Mathematics and Productivity the Student Room BSc, MSc & PhD Project Mangers etc
PPTs in SLIDESHARE International Studies Research Degrees (MPhilPhD) ➽➜R⇢➤=RESEARCH ➽=ALL
PPTs https://www.slideshare.net/DrFereidounDejahang/16-fd-my-news-punch-rev-16122019
MY NEWS PUNCH 16-12-2019
NEWS YOU WON’T FIND ON BBC-CNN-FOX NEWS, FRNACE 24, EURO NEWS
Articles for Political Science, Mathematics and Productivity the Student Room BSc, MSc & PhD Project Mangers etc
PPTs in SLIDESHARE International Studies Research Degrees (MPhilPhD)
Vaccine management system project report documentation..pdfKamal Acharya
The Division of Vaccine and Immunization is facing increasing difficulty monitoring vaccines and other commodities distribution once they have been distributed from the national stores. With the introduction of new vaccines, more challenges have been anticipated with this additions posing serious threat to the already over strained vaccine supply chain system in Kenya.
Forklift Classes Overview by Intella PartsIntella Parts
Discover the different forklift classes and their specific applications. Learn how to choose the right forklift for your needs to ensure safety, efficiency, and compliance in your operations.
For more technical information, visit our website https://intellaparts.com
Immunizing Image Classifiers Against Localized Adversary Attacksgerogepatton
This paper addresses the vulnerability of deep learning models, particularly convolutional neural networks
(CNN)s, to adversarial attacks and presents a proactive training technique designed to counter them. We
introduce a novel volumization algorithm, which transforms 2D images into 3D volumetric representations.
When combined with 3D convolution and deep curriculum learning optimization (CLO), itsignificantly improves
the immunity of models against localized universal attacks by up to 40%. We evaluate our proposed approach
using contemporary CNN architectures and the modified Canadian Institute for Advanced Research (CIFAR-10
and CIFAR-100) and ImageNet Large Scale Visual Recognition Challenge (ILSVRC12) datasets, showcasing
accuracy improvements over previous techniques. The results indicate that the combination of the volumetric
input and curriculum learning holds significant promise for mitigating adversarial attacks without necessitating
adversary training.
Final project report on grocery store management system..pdfKamal Acharya
In today’s fast-changing business environment, it’s extremely important to be able to respond to client needs in the most effective and timely manner. If your customers wish to see your business online and have instant access to your products or services.
Online Grocery Store is an e-commerce website, which retails various grocery products. This project allows viewing various products available enables registered users to purchase desired products instantly using Paytm, UPI payment processor (Instant Pay) and also can place order by using Cash on Delivery (Pay Later) option. This project provides an easy access to Administrators and Managers to view orders placed using Pay Later and Instant Pay options.
In order to develop an e-commerce website, a number of Technologies must be studied and understood. These include multi-tiered architecture, server and client-side scripting techniques, implementation technologies, programming language (such as PHP, HTML, CSS, JavaScript) and MySQL relational databases. This is a project with the objective to develop a basic website where a consumer is provided with a shopping cart website and also to know about the technologies used to develop such a website.
This document will discuss each of the underlying technologies to create and implement an e- commerce website.
CFD Simulation of By-pass Flow in a HRSG module by R&R Consult.pptxR&R Consult
CFD analysis is incredibly effective at solving mysteries and improving the performance of complex systems!
Here's a great example: At a large natural gas-fired power plant, where they use waste heat to generate steam and energy, they were puzzled that their boiler wasn't producing as much steam as expected.
R&R and Tetra Engineering Group Inc. were asked to solve the issue with reduced steam production.
An inspection had shown that a significant amount of hot flue gas was bypassing the boiler tubes, where the heat was supposed to be transferred.
R&R Consult conducted a CFD analysis, which revealed that 6.3% of the flue gas was bypassing the boiler tubes without transferring heat. The analysis also showed that the flue gas was instead being directed along the sides of the boiler and between the modules that were supposed to capture the heat. This was the cause of the reduced performance.
Based on our results, Tetra Engineering installed covering plates to reduce the bypass flow. This improved the boiler's performance and increased electricity production.
It is always satisfying when we can help solve complex challenges like this. Do your systems also need a check-up or optimization? Give us a call!
Work done in cooperation with James Malloy and David Moelling from Tetra Engineering.
More examples of our work https://www.r-r-consult.dk/en/cases-en/
Industrial Training at Shahjalal Fertilizer Company Limited (SFCL)MdTanvirMahtab2
This presentation is about the working procedure of Shahjalal Fertilizer Company Limited (SFCL). A Govt. owned Company of Bangladesh Chemical Industries Corporation under Ministry of Industries.
Automobile Management System Project Report.pdfKamal Acharya
The proposed project is developed to manage the automobile in the automobile dealer company. The main module in this project is login, automobile management, customer management, sales, complaints and reports. The first module is the login. The automobile showroom owner should login to the project for usage. The username and password are verified and if it is correct, next form opens. If the username and password are not correct, it shows the error message.
When a customer search for a automobile, if the automobile is available, they will be taken to a page that shows the details of the automobile including automobile name, automobile ID, quantity, price etc. “Automobile Management System” is useful for maintaining automobiles, customers effectively and hence helps for establishing good relation between customer and automobile organization. It contains various customized modules for effectively maintaining automobiles and stock information accurately and safely.
When the automobile is sold to the customer, stock will be reduced automatically. When a new purchase is made, stock will be increased automatically. While selecting automobiles for sale, the proposed software will automatically check for total number of available stock of that particular item, if the total stock of that particular item is less than 5, software will notify the user to purchase the particular item.
Also when the user tries to sale items which are not in stock, the system will prompt the user that the stock is not enough. Customers of this system can search for a automobile; can purchase a automobile easily by selecting fast. On the other hand the stock of automobiles can be maintained perfectly by the automobile shop manager overcoming the drawbacks of existing system.
Student information management system project report ii.pdfKamal Acharya
Our project explains about the student management. This project mainly explains the various actions related to student details. This project shows some ease in adding, editing and deleting the student details. It also provides a less time consuming process for viewing, adding, editing and deleting the marks of the students.
2. COMMUNICATION

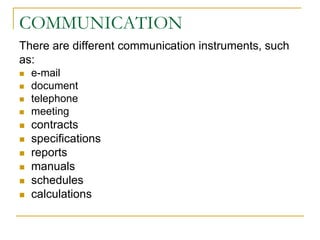

There are different communication instruments, such
as:
e-mail
document
telephone
meeting
contracts
specifications
reports
manuals
schedules
calculations
3. COMMUNICATION

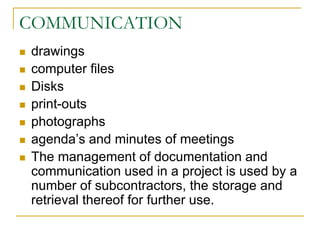

drawings
computer files
Disks
print-outs
photographs
agenda’s and minutes of meetings
The management of documentation and
communication used in a project is used by a
number of subcontractors, the storage and
retrieval thereof for further use.

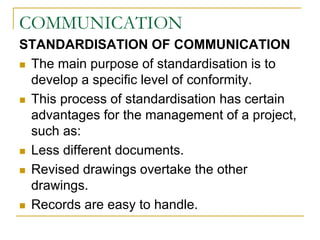

4. COMMUNICATION
STANDARDISATION OF COMMUNICATION
The main purpose of standardisation is to
develop a specific level of conformity.
This process of standardisation has certain
advantages for the management of a project,
such as:
Less different documents.
Revised drawings overtake the other
drawings.
Records are easy to handle.
5. COMMUNICATION

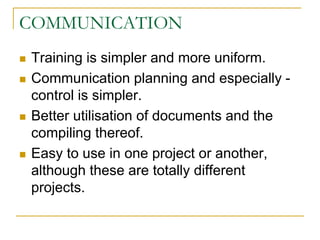

Training is simpler and more uniform.
Communication planning and especially -
control is simpler.
Better utilisation of documents and the
compiling thereof.
Easy to use in one project or another,
although these are totally different
projects.

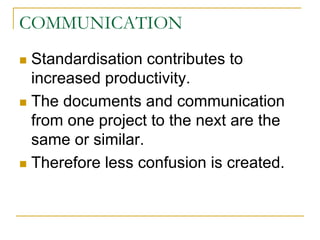

6. COMMUNICATION
Standardisation contributes to
increased productivity.
The documents and communication
from one project to the next are the
same or similar.
Therefore less confusion is created.
7. COMMUNICATION

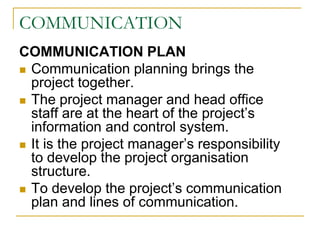

COMMUNICATION PLAN
Communication planning brings the
project together.
The project manager and head office
staff are at the heart of the project’s
information and control system.
It is the project manager’s responsibility
to develop the project organisation
structure.
To develop the project’s communication
plan and lines of communication.
8. COMMUNICATION

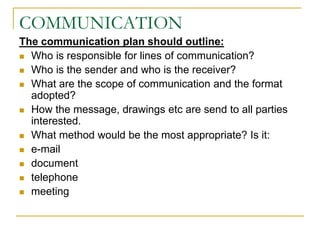

The communication plan should outline:
Who is responsible for lines of communication?
Who is the sender and who is the receiver?
What are the scope of communication and the format
adopted?
How the message, drawings etc are send to all parties
interested.
What method would be the most appropriate? Is it:
e-mail
document
telephone
meeting
9. COMMUNICATION
presentation
Feedback (confirm message received
and understood – document control)
Filing system:
retrieval
storing
disaster recovery

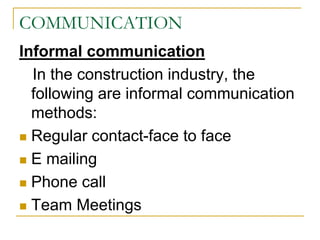

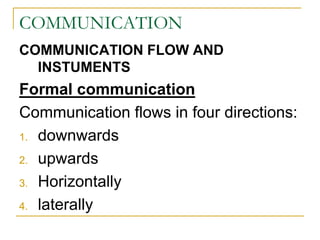

12. COMMUNICATION
Informal communication
In the construction industry, the
following are informal communication
methods:
Regular contact-face to face
E mailing
Phone call
Team Meetings

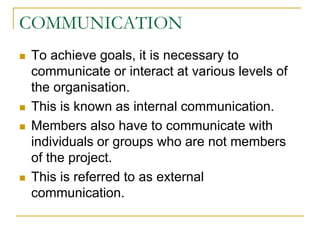

14. COMMUNICATION
To achieve goals, it is necessary to
communicate or interact at various levels of
the organisation.
This is known as internal communication.
Members also have to communicate with
individuals or groups who are not members
of the project.
This is referred to as external
communication.

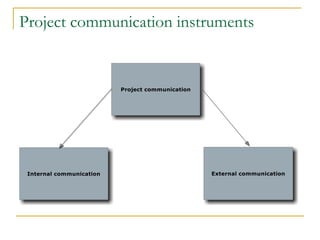

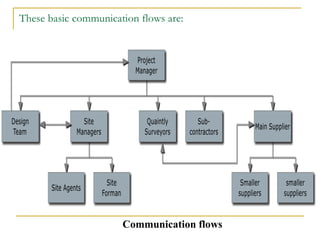

15. COMMUNICATION

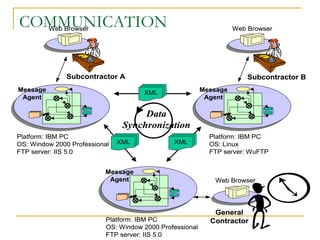

Subcontractor BSubcontractor A
Web Browser
General
Contractor
Web Browser
Web Browser
XML XML
XML
Message
Agent
Message
Agent
Message
Agent
Platform: IBM PC
OS: Window 2000 Professional
FTP server: IIS 5.0
Platform: IBM PC
OS: Linux
FTP server: WuFTP
Platform: IBM PC
OS: Window 2000 Professional
FTP server: IIS 5.0
Data
Synchronization
Subcontractor BSubcontractor A
Web Browser
General
Contractor
Web Browser
Web Browser
XML XML
XML
Message
Agent
Message
Agent
Message
Agent
Message
Agent
Message
Agent
Message
Agent
Platform: IBM PC
OS: Window 2000 Professional
FTP server: IIS 5.0
Platform: IBM PC
OS: Linux
FTP server: WuFTP
Platform: IBM PC
OS: Window 2000 Professional
FTP server: IIS 5.0
Data
Synchronization

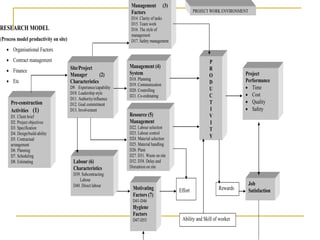

20. RESEARCH MODEL
(Process model productivity on site)
Organisational Factors
Contract management
Finance
Etc
PROJECT WORK ENVIRONMENT
Pre-construction
Activities (1)
D1. Client brief
D2. Project objectives
D3. Specification
D4. Design/build-ability
D5. Contractual
arrangement
D6. Planning
D7. Scheduling
D8. Estimating
Site/Project
Manager (2)
Characteristics

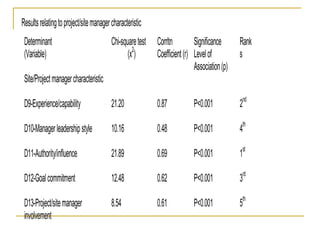

D9. Experience/capability
D10. Leadership style
D11. Authority/influence
D12. Goal commitment
D13. Involvement
Labour (6)
Characteristics
D39. Subcontracting
Labour
D40. Direct labour
Management (3)
Factors
D14. Clarity of tasks
D15. Team work
D16. The style of
management
D17. Safety management
Management (4)
System
D18. Planning
D19. Communication
D20. Controlling
D21. Co-ordinating
Resource (5)
Management
D22. Labour selection
D23. Labour control
D24. Material selection
D25. Material handling
D26. Plant
D27. D31. Waste on site
D32. D38. Delay and
Disruption on site
Motivating
Factors (7)
D41-D46
Hygiene
Factors
D47-D55
P
R
O
D
U
C
T
I
V
I
T
Y

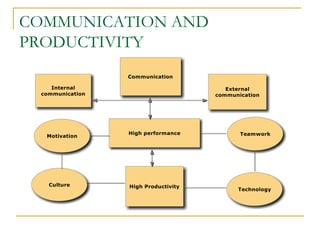

Project
Performance
Time
Cost
Quality
Safety
Job
SatisfactionEffort Rewards
Ability and Skill of worker
21. COMMUNICATION RANKING-
RESULT OF A SURVEY
Bivariate/ inferential analysis
Bivariate/ inferential analysis
examines the relationship between the research
variables and case studies
by applying correlation coefficient and chi-
square test
development of a hypothesis and sub-
hypothesis
22. COMMUNICATION RANKING-
RESULT OF A SURVEY
16 case studies with a high level of
productivity.
16 case studies with a low level of productivity
were investigated in the London area.
All of the construction firms who participated
in the case studies are involved in providing
homes for Housing Associations.
23. COMMUNICATION

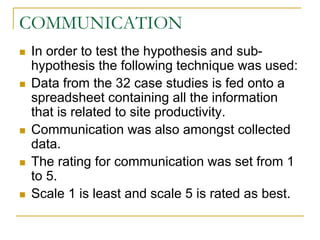

In order to test the hypothesis and sub-
hypothesis the following technique was used:
Data from the 32 case studies is fed onto a
spreadsheet containing all the information
that is related to site productivity.
Communication was also amongst collected
data.
The rating for communication was set from 1
to 5.
Scale 1 is least and scale 5 is rated as best.

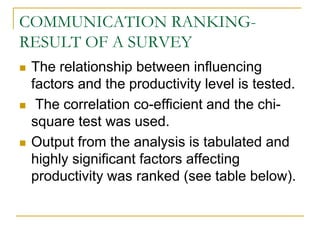

24. COMMUNICATION RANKING-
RESULT OF A SURVEY
The relationship between influencing
factors and the productivity level is tested.
The correlation co-efficient and the chi-
square test was used.
Output from the analysis is tabulated and
highly significant factors affecting
productivity was ranked (see table below).

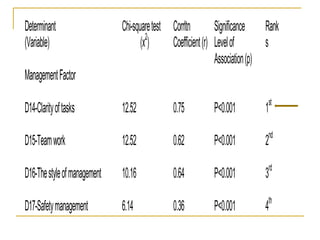

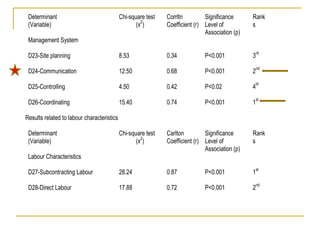

28. Determinant
(Variable)
Chi-square test
(x
2
)
Corrltn
Coefficient (r)
Significance
Level of
Association (p)
Resource Management-Box 4
D18-Labour Selection 1.24 -0.09 P<0.1(No
significance)
D19-Labour Control 21.20 0.75 P<0.001
D20-Material Selection 21.20 0.67 P<0.001
D21-Material Handling 10.78 0.74 P<0.001
D22-Plant 10.90 0.56 P<0.001
Waste on site following
D29-Design change 1.12 0.42 P<0.1(No
significance)
D30- Design error 8.0 0.55 P<0.001
D31-Bad workmanship 9.14 0.56 P<0.001
D32-Bad handling of material 0.5 0.09 P<0.5(No
significance)

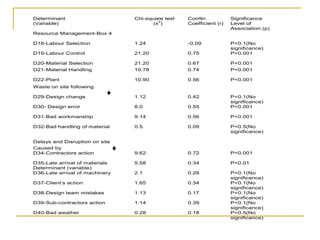

Delays and Disruption on site
Caused by
D34-Contractors action 9.62 0.72 P<0.001
D35-Late arrival of materials
Determinant (variable)
5.58 0.34 P<0.01
D36-Late arrival of machinery 2.1 0.28 P<0.1(No
significance)
D37-Client’s action 1.65 0.34 P<0.1(No
significance)
D38-Design team mistakes 1.13 0.17 P<0.1(No
significance)
D39-Sub-contractors action 1.14 0.39 P<0.1(No
significance)
D40-Bad weather 0.28 0.18 P<0.5(No
significance)
29. Determinant
(Variable)
Chi-square test
(x
2
)
Corrltn
Coefficient (r)
Significance
Level of
Association (p)
Rank
s
Management System
D23-Site planning
D24-Communication
D25-Controlling
D26-Coordinating
8.53
12.50
4.50
15.40
0.34
0.68
0.42
0.74
P<0.001
P<0.001
P<0.02
P<0.001
3rd
2
nd
4th
1
st
Results related to labour characteristics
Determinant
(Variable)
Chi-square test
(x
2
)
Carlton
Coefficient (r)
Significance
Level of
Association (p)
Rank
s
Labour Characteristics
D27-Subcontracting Labour
D28-Direct Labour
28.24
17.88
0.87
0.72
P<0.001
P<0.001
1
st
2
nd

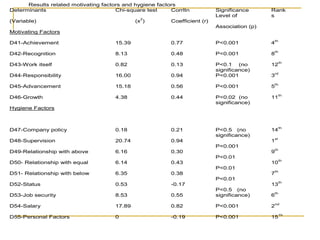

30. Results related motivating factors and hygiene factors
Determinants
(Variable)
Chi-square test
(x
2
)
Corrltn
Coefficient (r)
Significance
Level of
Association (p)
Rank
s
Motivating Factors
D41-Achievement
D42-Recognition
D43-Work itself
D44-Responsibility
D45-Advancement
D46-Growth
Hygiene Factors
D47-Company policy
D48-Supervision
D49-Relationship with above
D50- Relationship with equal
D51- Relationship with below
D52-Status
D53-Job security
D54-Salary
D55-Personal Factors
15.39
8.13
0.82
16.00
15.18
4.38
0.18
20.74
6.16
6.14
6.35
0.53
8.53
17.89
0
0.77
0.48
0.13
0.94
0.56
0.44
0.21
0.94
0.30
0.43
0.38
-0.17
0.55
0.82
-0.19
P<0.001
P<0.001
P<0.1 (no
significance)
P<0.001
P<0.001
P<0.02 (no
significance)
P<0.5 (no
significance)
P<0.001
P<0.01
P<0.01
P<0.01
P<0.5 (no
significance)
P<0.001
P<0.001
4
th
8
th
12th
3
rd
5
th
11
th
14
th
1
st
9
th
10
th
7
th
13
th
6
th
2nd
15
1h
31. DEVELOPMENT OF A MODEL
CONSIDER VARIABLES WITHIN THE
PROCESS MODEL
CONSIDER ALL SFACTORS-
INETERNAL AND EXTERNAL
DEVELOP A RELATIONSHIP BETWEEN
PRODUCTIVITY AND EFFECTIVE
COMMUNICATION
DEVELOP A PROCESS MODEL
READ ABOUT PRINCE 2-NOT
RECOMMENDED.
