More Related Content Similar to Supply Chain Management chap 8
Similar to Supply Chain Management chap 8 (20) More from Umair Arain (13) Supply Chain Management chap 81. PowerPoint presentation to accompany
Chopra and Meindl Supply Chain Management, 5e
1-1
Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.
1-1
Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.
1-1
Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.
8-1
Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.
8
Aggregate
Planning in a
Supply Chain
2. 8-2Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.

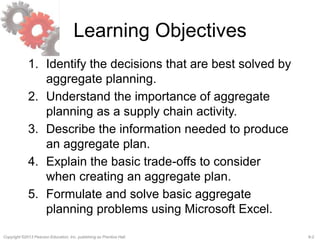

Learning Objectives
1. Identify the decisions that are best solved by
aggregate planning.
2. Understand the importance of aggregate
planning as a supply chain activity.
3. Describe the information needed to produce
an aggregate plan.
4. Explain the basic trade-offs to consider
when creating an aggregate plan.
5. Formulate and solve basic aggregate
planning problems using Microsoft Excel.

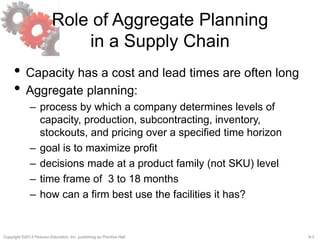

3. 8-3Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.
Role of Aggregate Planning
in a Supply Chain
• Capacity has a cost and lead times are often long
• Aggregate planning:
– process by which a company determines levels of
capacity, production, subcontracting, inventory,
stockouts, and pricing over a specified time horizon
– goal is to maximize profit
– decisions made at a product family (not SKU) level
– time frame of 3 to 18 months
– how can a firm best use the facilities it has?

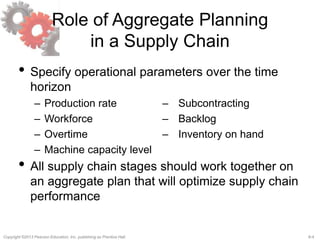

4. 8-4Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.
Role of Aggregate Planning
in a Supply Chain
• Specify operational parameters over the time
horizon
– Production rate – Subcontracting
– Workforce – Backlog
– Overtime – Inventory on hand
– Machine capacity level
• All supply chain stages should work together on
an aggregate plan that will optimize supply chain
performance
5. 8-5Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.

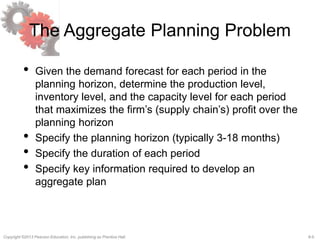

The Aggregate Planning Problem
• Given the demand forecast for each period in the
planning horizon, determine the production level,
inventory level, and the capacity level for each period
that maximizes the firm’s (supply chain’s) profit over the
planning horizon
• Specify the planning horizon (typically 3-18 months)
• Specify the duration of each period
• Specify key information required to develop an
aggregate plan
6. 8-6Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.

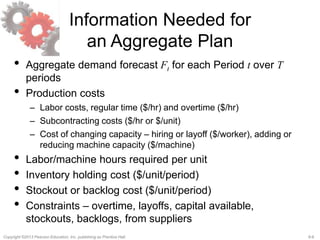

Information Needed for
an Aggregate Plan
• Aggregate demand forecast Ft for each Period t over T
periods
• Production costs
– Labor costs, regular time ($/hr) and overtime ($/hr)
– Subcontracting costs ($/hr or $/unit)
– Cost of changing capacity – hiring or layoff ($/worker), adding or
reducing machine capacity ($/machine)
• Labor/machine hours required per unit
• Inventory holding cost ($/unit/period)
• Stockout or backlog cost ($/unit/period)
• Constraints – overtime, layoffs, capital available,
stockouts, backlogs, from suppliers
7. 8-7Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.

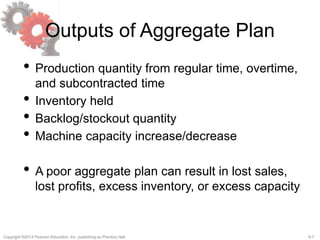

Outputs of Aggregate Plan
• Production quantity from regular time, overtime,
and subcontracted time
• Inventory held
• Backlog/stockout quantity
• Machine capacity increase/decrease
• A poor aggregate plan can result in lost sales,
lost profits, excess inventory, or excess capacity

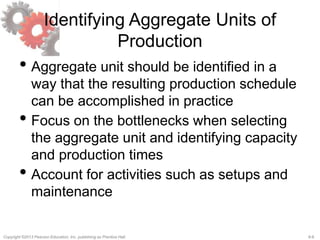

8. 8-8Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.
Identifying Aggregate Units of
Production
• Aggregate unit should be identified in a
way that the resulting production schedule
can be accomplished in practice
• Focus on the bottlenecks when selecting
the aggregate unit and identifying capacity
and production times
• Account for activities such as setups and
maintenance
9. 8-9Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.
Red Tomato Tools
Family
Material
Cost/
Unit ($)
Revenue/
Unit ($)
Setup
Time/B
atch
(hour)
Average
Batch
Size
Production
Time/ Unit
(hour)
Net
Production
Time/Unit
(hour)
Percentage
Share of
Units Sold
A 15 54 8 50 5.60 5.76 10
B 7 30 6 150 3.00 3.04 25
C 9 39 8 100 3.80 3.88 20
D 12 49 10 50 4.80 5.00 10
E 9 36 6 100 3.60 3.66 20
F 13 48 5 75 4.30 4.37 15
Table 8-1
10. 8-10Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.
Red Tomato Tools
• Weighted average approach
Material cost per aggregate unit
= 15 x 0.10 + 7 x 0.25 + 9 x 0.20
+ 12 x 0.10 + 9 x 0.20 + 13 x 0.15
= $10
• Similarly
Revenue per aggregate unit = $40
Net production time per aggregate unit = 4.00 hours
11. 8-11Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.
Aggregate Planning Strategies
• Trade-off between capacity, inventory,
backlog/lost sales
• Chase strategy – using capacity as the
lever
• Time flexibility from workforce or capacity
strategy – using utilization as the lever
• Level strategy – using inventory as the
lever
• Tailored or hybrid strategy – a
combination of strategies
12. 8-12Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.
Chase Strategy
• Vary machine capacity or hire and lay off
workers as demand varies
• Often difficult to vary capacity and workforce
on short notice
• Expensive if cost of varying capacity is high
• Negative effect on workforce morale
• Results in low levels of inventory
• Used when inventory holding costs are high
and costs of changing capacity are low

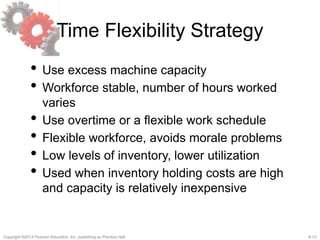

13. 8-13Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.
Time Flexibility Strategy
• Use excess machine capacity
• Workforce stable, number of hours worked
varies
• Use overtime or a flexible work schedule
• Flexible workforce, avoids morale problems
• Low levels of inventory, lower utilization
• Used when inventory holding costs are high
and capacity is relatively inexpensive

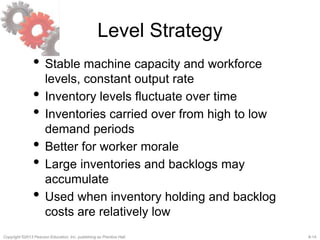

14. 8-14Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.
Level Strategy
• Stable machine capacity and workforce
levels, constant output rate
• Inventory levels fluctuate over time
• Inventories carried over from high to low
demand periods
• Better for worker morale
• Large inventories and backlogs may
accumulate
• Used when inventory holding and backlog
costs are relatively low
15. 8-15Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.

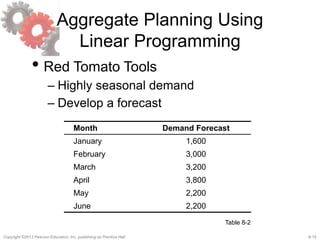

Aggregate Planning Using
Linear Programming
• Red Tomato Tools
– Highly seasonal demand
– Develop a forecast
Month Demand Forecast
January 1,600
February 3,000
March 3,200
April 3,800
May 2,200
June 2,200
Table 8-2

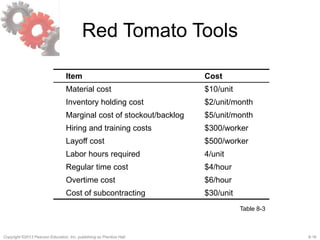

16. 8-16Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.
Red Tomato Tools
Item Cost
Material cost $10/unit
Inventory holding cost $2/unit/month
Marginal cost of stockout/backlog $5/unit/month
Hiring and training costs $300/worker
Layoff cost $500/worker
Labor hours required 4/unit
Regular time cost $4/hour
Overtime cost $6/hour
Cost of subcontracting $30/unit
Table 8-3
17. 8-17Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.

Red Tomato Tools

Decision Variables
For t = 1, ..., 6
Wt = Workforce size for month t
Ht = Number of employees hired at the beginning of
month t
Lt = Number of employees laid off at the beginning of
month t
Pt = Production in month t
It = Inventory at the end of month t
St = Number of units stocked out at the end of month t
Ct = Number of units subcontracted for month t
Ot = Number of overtime hours worked in month t
18. 8-18Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.

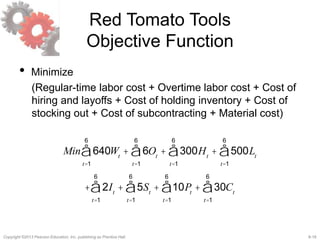

Red Tomato Tools
Objective Function
• Minimize
(Regular-time labor cost + Overtime labor cost + Cost of
hiring and layoffs + Cost of holding inventory + Cost of
stocking out + Cost of subcontracting + Material cost)
Min 640Wt
t=1
6
å + 6Ot
t=1
6
å + 300Ht
t=1
6
å + 500Lt
t=1
6
å
+ 2It
t=1
6
å + 5St
t=1
6
å + 10Pt
t=1
6
å + 30Ct
t=1
6
å
19. 8-19Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.

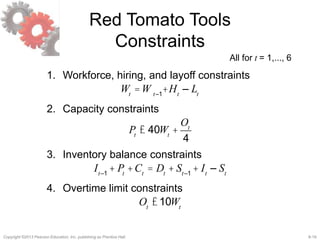

Red Tomato Tools
Constraints
1. Workforce, hiring, and layoff constraints
All for t = 1,..., 6
Wt
=W t–1
+Ht
– Lt
2. Capacity constraints
Pt
£ 40Wt
+
Ot
4
3. Inventory balance constraints
It–1
+ Pt
+Ct
= Dt
+ St–1
+ It
– St
4. Overtime limit constraints
Ot
£10Wt
20. 8-20Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.

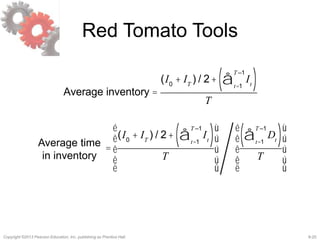

Red Tomato Tools
Average inventory =
(I0
+ IT
) / 2+ Itt=1
T –1
å( )
T
=
(I0
+ IT
) / 2+ Itt=1
T –1
å( )
T
é
ë
ê
ê
ê
ù
û
ú
ú
ú
Dtt=1
T –1
å( )
T
é
ë
ê
ê
ê
ù
û
ú
ú
ú
Average time
in inventory
21. 8-21Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.

Red Tomato Tools
Total cost over planning horizon = $422,275
Revenue over planning horizon = 40 x 16,000 = $640,000
Period,
t
No.
Hired,
Ht
No.
Laid
Off,
Lt
Workforce
Size, Wt
Overtime,
Ot
Inventory,
It
Stockout,
St
Subcontract
, Ct
Total
Production,
Pt
0 0 0 80 0 1,000 0 0
1 0 15 65 0 1,983 0 0 2,583
2 0 0 65 0 1,567 0 0 2,583
3 0 0 65 0 950 0 0 2,583
4 0 0 65 0 0 267 0 2,583
5 0 0 65 0 117 0 0 2,583
6 0 0 65 0 500 0 0 2,583
Table 8-4
22. 8-22Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.

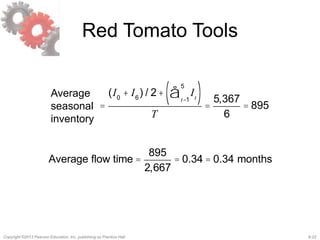

Red Tomato Tools
=
(I0
+ I6
) / 2+ Itt=1
5
å( )
T
=
5,367
6
= 895
Average
seasonal
inventory
Average flow time =
895
2,667
= 0.34 = 0.34 months
23. 8-23Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.

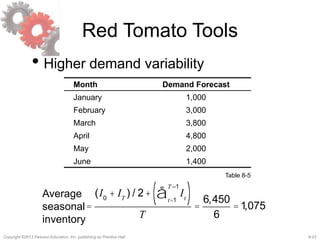

Red Tomato Tools
• Higher demand variability
Month Demand Forecast
January 1,000
February 3,000
March 3,800
April 4,800
May 2,000
June 1,400
Table 8-5
=
(I0
+ IT
) / 2+ Itt=1
T –1
å( )
T
=
6,450
6
=1,075
Average
seasonal
inventory

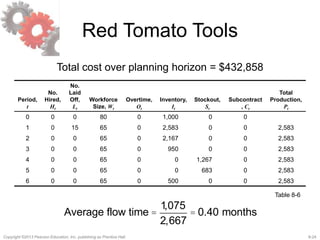

24. 8-24Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.
Red Tomato Tools
Total cost over planning horizon = $432,858
Period,
t
No.
Hired,
Ht
No.
Laid
Off,
Lt
Workforce
Size, Wt
Overtime,
Ot
Inventory,
It
Stockout,
St
Subcontract
, Ct
Total
Production,
Pt
0 0 0 80 0 1,000 0 0
1 0 15 65 0 2,583 0 0 2,583
2 0 0 65 0 2,167 0 0 2,583
3 0 0 65 0 950 0 0 2,583
4 0 0 65 0 0 1,267 0 2,583
5 0 0 65 0 0 683 0 2,583
6 0 0 65 0 500 0 0 2,583
Table 8-6
Average flow time =
1,075
2,667
= 0.40 months

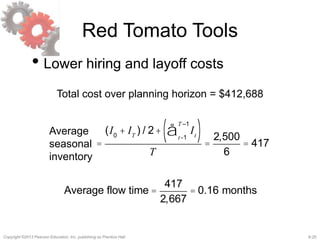

25. 8-25Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.
Red Tomato Tools
• Lower hiring and layoff costs
=
(I0
+ IT
) / 2+ Itt=1
T –1
å( )
T
=
2,500
6
= 417
Average
seasonal
inventory
Average flow time =
417
2,667
= 0.16 months
Total cost over planning horizon = $412,688

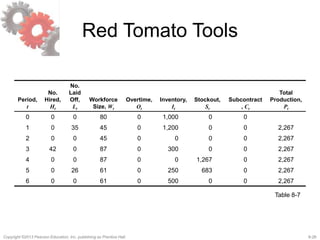

26. 8-26Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.
Red Tomato Tools
Period,
t
No.
Hired,
Ht
No.
Laid
Off,
Lt
Workforce
Size, Wt
Overtime,
Ot
Inventory,
It
Stockout,
St
Subcontract
, Ct
Total
Production,
Pt
0 0 0 80 0 1,000 0 0
1 0 35 45 0 1,200 0 0 2,267
2 0 0 45 0 0 0 0 2,267
3 42 0 87 0 300 0 0 2,267
4 0 0 87 0 0 1,267 0 2,267
5 0 26 61 0 250 683 0 2,267
6 0 0 61 0 500 0 0 2,267
Table 8-7
27. 8-27Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.

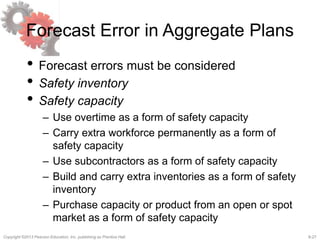

Forecast Error in Aggregate Plans
• Forecast errors must be considered
• Safety inventory
• Safety capacity
– Use overtime as a form of safety capacity
– Carry extra workforce permanently as a form of
safety capacity
– Use subcontractors as a form of safety capacity
– Build and carry extra inventories as a form of safety
inventory
– Purchase capacity or product from an open or spot
market as a form of safety capacity
28. 8-28Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.

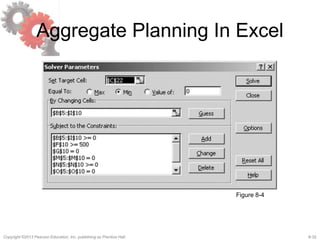

Aggregate Planning In Excel
For t = 1, ..., 6
Wt = Workforce size for Month t
Ht = Number of employees hired at the beginning
of Month t
Lt = Number of employees laid off at the
beginning of Month t
Pt = Production in Month t
It = Inventory at the end of Month t
St = Number of units stocked out at the end of
Month t
Ct = Number of units subcontracted for Month t
Ot = Number of overtime hours worked in Month t
33. 8-33Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.

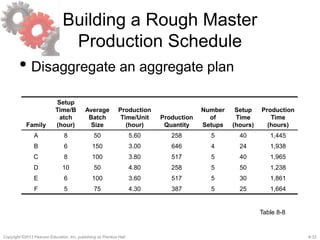

Building a Rough Master
Production Schedule
• Disaggregate an aggregate plan
Family
Setup
Time/B
atch
(hour)
Average
Batch
Size
Production
Time/Unit
(hour)
Production
Quantity
Number
of
Setups
Setup
Time
(hours)
Production
Time
(hours)
A 8 50 5.60 258 5 40 1,445
B 6 150 3.00 646 4 24 1,938
C 8 100 3.80 517 5 40 1,965
D 10 50 4.80 258 5 50 1,238
E 6 100 3.60 517 5 30 1,861
F 5 75 4.30 387 5 25 1,664
Table 8-8
34. 8-34Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.

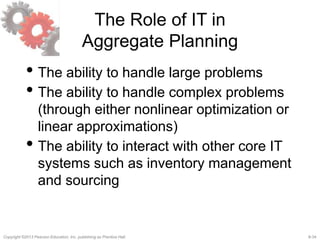

The Role of IT in
Aggregate Planning
• The ability to handle large problems
• The ability to handle complex problems
(through either nonlinear optimization or
linear approximations)
• The ability to interact with other core IT
systems such as inventory management
and sourcing
35. 8-35Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.

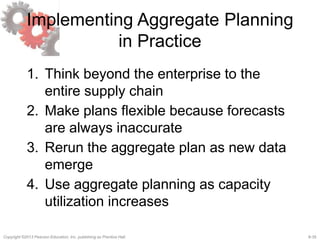

Implementing Aggregate Planning
in Practice
1. Think beyond the enterprise to the
entire supply chain
2. Make plans flexible because forecasts
are always inaccurate
3. Rerun the aggregate plan as new data
emerge
4. Use aggregate planning as capacity
utilization increases
36. 8-36Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.

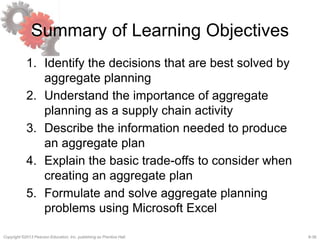

Summary of Learning Objectives
1. Identify the decisions that are best solved by
aggregate planning
2. Understand the importance of aggregate
planning as a supply chain activity
3. Describe the information needed to produce
an aggregate plan
4. Explain the basic trade-offs to consider when
creating an aggregate plan
5. Formulate and solve aggregate planning
problems using Microsoft Excel
37. 8-37Copyright ©2013 Pearson Education, Inc. publishing as Prentice Hall.
All rights reserved. No part of this publication may be reproduced, stored in a retrieval
system, or transmitted, in any form or by any means, electronic, mechanical, photocopying,
recording, or otherwise, without the prior written permission of the publisher.
Printed in the United States of America.
