Efficient Model Selection for Deep Neural Networks on Massively Parallel Proc...inside-BigData.com

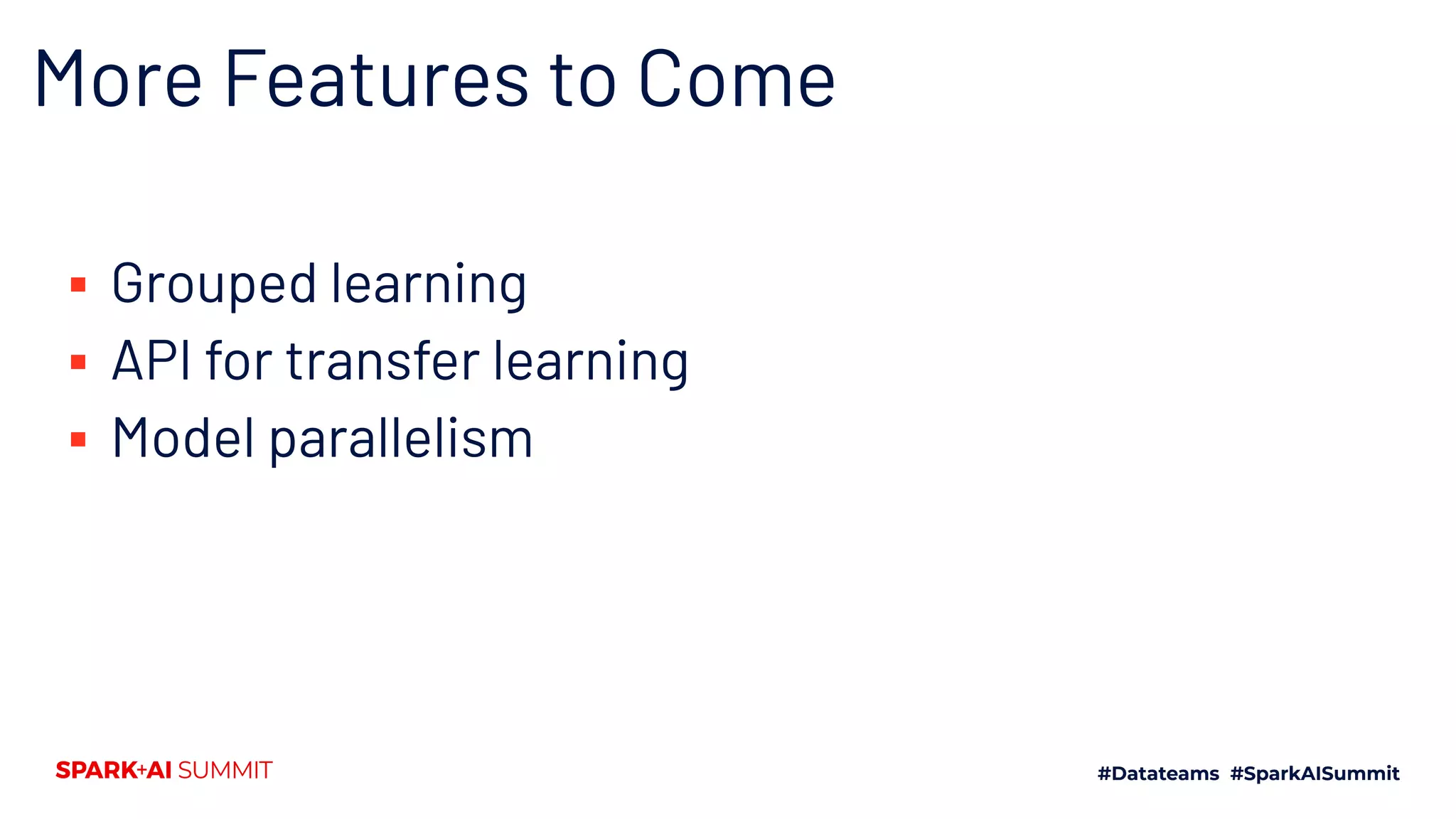

In this deck from FOSDEM 2020, Frank McQuillan from Pivotal presents: Efficient Model Selection for Deep Neural Networks on Massively Parallel Processing Databases.
"In this session we will present an efficient way to train many deep learning model configurations at the same time with Greenplum, a free and open source massively parallel database based on PostgreSQL. The implementation involves distributing data to the workers that have GPUs available and hopping model state between those workers, without sacrificing reproducibility or accuracy. Then we apply optimization algorithms to generate and prune the set of model configurations to try.
Deep neural networks are revolutionizing many machine learning applications, but hundreds of trials may be needed to generate a good model architecture and associated hyperparameters. This is the challenge of model selection. It is time consuming and expensive, especially if you are only training one model at a time.
Massively parallel processing databases can have hundreds of workers, so can you use this parallel compute architecture to address the challenge of model selection for deep nets, in order to make it faster and cheaper?
It’s possible!

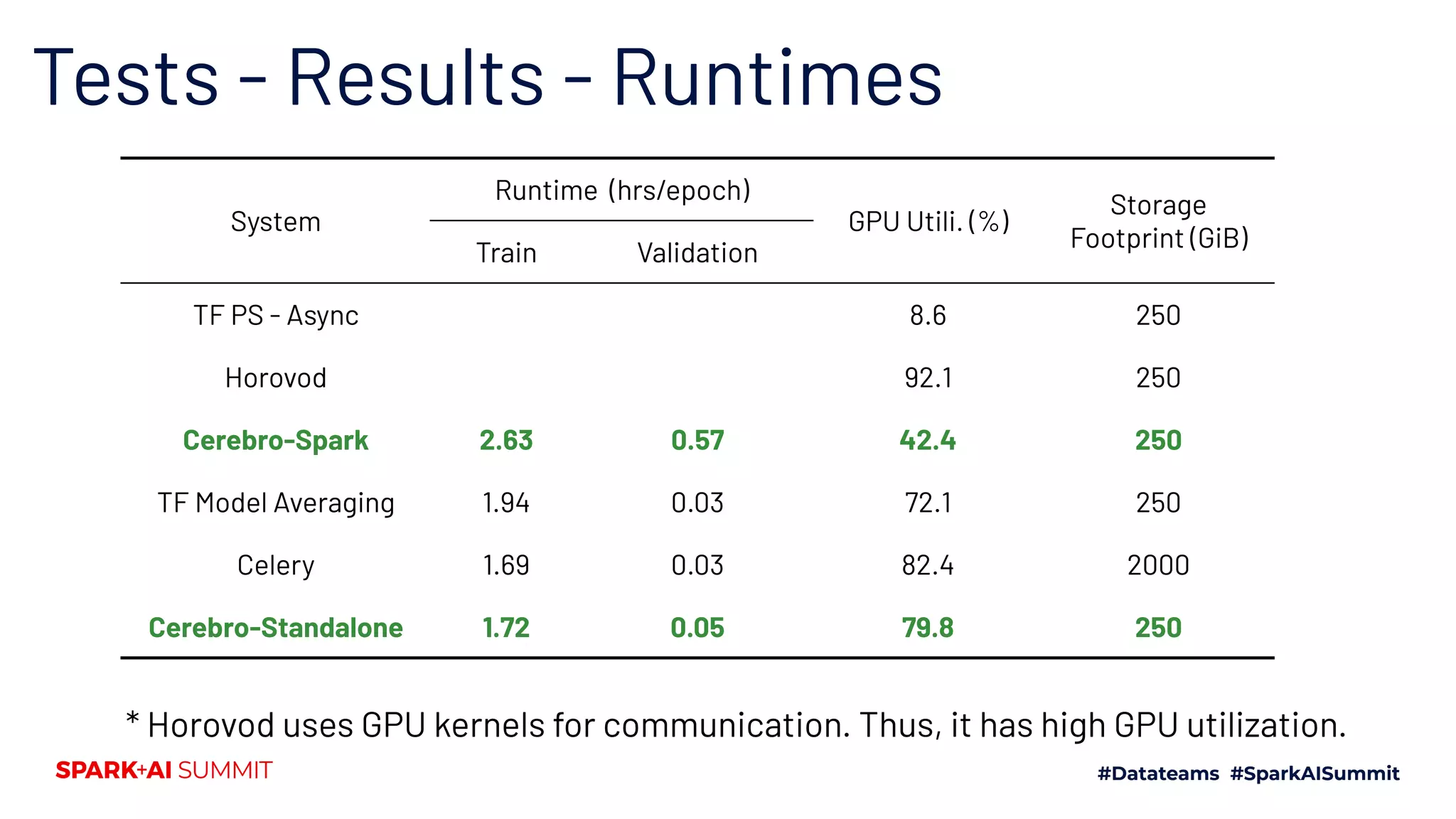

We will demonstrate results from this project using a version of Hyperband, which is a well known hyperparameter optimization algorithm, and the deep learning frameworks Keras and TensorFlow, all running on Greenplum database using Apache MADlib. Other topics will include architecture, scalability results and bright opportunities for the future."
Watch the video: https://wp.me/p3RLHQ-lsQ
Learn more: https://fosdem.org/2020/
Sign up for our insideHPC Newsletter: http://insidehpc.com/newsletter
Explore big data at speed of thought with Spark 2.0 and SnappydataData Con LA
Abstract:
Data exploration often requires running aggregation/slice-dice queries on data sourced from disparate sources. You may want to identify distribution patterns, outliers, etc and aid the feature selection process as you train your predictive models. As you begin to understand your data, you want to ask ad-hoc questions expressed through your visualization tool (which typically translates to SQL queries), study the results and iteratively explore the data set through more queries. Unfortunately, even when data sets can be in-memory, large data set computations take time breaking the train of thought and increasing time to insight . We know Spark can be fast through its in-memory parallel processing. But, Spark 1.x isn’t quite there. Spark 2.0 promises to offer 10X better speed than its predecessor. Spark 2.0 ushers some impressive improvements to interactive query performance. We first explore these advances - compiling the query plan eliminating virtual function calls, and other improvements in the Catalyst engine. We compare the performance to other popular popular query processing engines by studying the spark query plans. We then go through SnappyData (an open source project that integrates Spark with a database that offers OLTP, OLAP and stream processing in a single cluster) where we use smarter data colocation and Synopses data (.e.g. Stratified sampling) to dramatically cut down on the memory requirements as well as the query latency. We explain the key concepts in summarizing data using structures like stratified sampling by walking through some examples in Apache Zeppelin notebooks (a open source visualization tool for spark) and demonstrate how we can explore massive data sets with just your laptop resources while achieving remarkable speeds.
Bio:
Jags is a founder and the CTO of SnappyData. Previously, Jags was the Chief Architect for “fast data” products at Pivotal and served in the extended leadership team of the company. At Pivotal and previously at VMWare, he led the technology direction for GemFire and other distributed in-memory Bio:
Jags Ramnarayan is a founder and the CTO of SnappyData. Previously, Jags was the Chief Architect for “fast data” products at Pivotal and served in the extended leadership team of the company. At Pivotal and previously at VMWare, he led the technology direction for GemFire and other distributed in-memory products.
End-to-End Deep Learning with Horovod on Apache SparkDatabricks
Data processing and deep learning are often split into two pipelines, one for ETL processing, the second for model training. Enabling deep learning frameworks to integrate seamlessly with ETL jobs allows for more streamlined production jobs, with faster iteration between feature engineering and model training.
Despite the increase of deep learning practitioners and researchers, many of them do not use GPUs, this may lead to long training/evaluation cycles and non-practical research.
In his talk, Lior shares how to get started with GPUs and some of the best practices that helped him during research and work. The talk is for everyone who works with machine learning (deep learning experience is NOT mandatory!), It covers the very basics of how GPU works, CUDA drivers, IDE configuration, training, inference, and multi-GPU training.
Two popular tools for doing Machine Learning on top of JVM ecosystem is H2O and SparkML. This presentation compares these two tools as Machine Learning libraries (Didn't consider Spark's Data Munjing perspective). This work was done during June of 2018.
Project Tungsten Phase II: Joining a Billion Rows per Second on a LaptopDatabricks
Tech-talk at Bay Area Apache Spark Meetup.
Apache Spark 2.0 will ship with the second generation Tungsten engine. Building upon ideas from modern compilers and MPP databases, and applying them to data processing queries, we have started an ongoing effort to dramatically improve Spark’s performance and bringing execution closer to bare metal. In this talk, we’ll take a deep dive into Apache Spark 2.0’s execution engine and discuss a number of architectural changes around whole-stage code generation/vectorization that have been instrumental in improving CPU efficiency and gaining performance.
Using Deep Learning on Apache Spark to Diagnose Thoracic Pathology from Chest...Databricks
Overview and extended description: AI is expected to be the engine of technological advancements in the healthcare industry, especially in the areas of radiology and image processing. The purpose of this session is to demonstrate how we can build a AI-based Radiologist system using Apache Spark and Analytics Zoo to detect pneumonia and other diseases from chest x-ray images. The dataset, released by the NIH, contains around 110,00 X-ray images of around 30,000 unique patients, annotated with up to 14 different thoracic pathology labels. Stanford University developed a state-of-the-art model using CNN and exceeds average radiologist performance on the F1 metric. This talk focuses on how we can build a multi-label image classification model in a distributed Apache Spark infrastructure, and demonstrate how to build complex image transformations and deep learning pipelines using BigDL and Analytics Zoo with scalability and ease of use. Some practical image pre-processing procedures and evaluation metrics are introduced. We will also discuss runtime configuration, near-linear scalability for training and model serving, and other general performance topics.
SF Big Analytics & SF Machine Learning Meetup: Machine Learning at the Limit ...Chester Chen
Machine Learning at the Limit
John Canny, UC Berkeley
How fast can machine learning and graph algorithms be? In "roofline" design, every kernel is driven toward the limits imposed by CPU, memory, network etc. This can lead to dramatic improvements: BIDMach is a toolkit for machine learning that uses rooflined design and GPUs to achieve two- to three-orders of magnitude improvements over other toolkits on single machines. These speedups are larger than have been reported for *cluster* systems (e.g. Spark/MLLib, Powergraph) running on hundreds of nodes, and BIDMach with a GPU outperforms these systems for most common machine learning tasks. For algorithms (e.g. graph algorithms) which do require cluster computing, we have developed a rooflined network primitive called "Kylix". We can show that Kylix approaches the rooline limits for sparse Allreduce, and empirically holds the record for distributed Pagerank. Beyond rooflining, we believe there are great opportunities from deep algorithm/hardware codesign. Gibbs Sampling (GS) is a very general tool for inference, but is typically much slower than alternatives. SAME (State Augmentation for Marginal Estimation) is a variation of GS which was developed for marginal parameter estimation. We show that it has high parallelism, and a fast GPU implementation. Using SAME, we developed a GS implementation of Latent Dirichlet Allocation whose running time is 100x faster than other samplers, and within 3x of the fastest symbolic methods. We are extending this approach to general graphical models, an area where there is currently a void of (practically) fast tools. It seems at least plausible that a general-purpose solution based on these techniques can closely approach the performance of custom algorithms.
Bio
John Canny is a professor in computer science at UC Berkeley. He is an ACM dissertation award winner and a Packard Fellow. He is currently a Data Science Senior Fellow in Berkeley's new Institute for Data Science and holds a INRIA (France) International Chair. Since 2002, he has been developing and deploying large-scale behavioral modeling systems. He designed and protyped production systems for Overstock.com, Yahoo, Ebay, Quantcast and Microsoft. He currently works on several applications of data mining for human learning (MOOCs and early language learning), health and well-being, and applications in the sciences.
Data Lakehouse Symposium | Day 1 | Part 1Databricks
The world of data architecture began with applications. Next came data warehouses. Then text was organized into a data warehouse.
Then one day the world discovered a whole new kind of data that was being generated by organizations. The world found that machines generated data that could be transformed into valuable insights. This was the origin of what is today called the data lakehouse. The evolution of data architecture continues today.
Come listen to industry experts describe this transformation of ordinary data into a data architecture that is invaluable to business. Simply put, organizations that take data architecture seriously are going to be at the forefront of business tomorrow.
This is an educational event.
Several of the authors of the book Building the Data Lakehouse will be presenting at this symposium.
Data Lakehouse Symposium | Day 1 | Part 2Databricks
The world of data architecture began with applications. Next came data warehouses. Then text was organized into a data warehouse.
Then one day the world discovered a whole new kind of data that was being generated by organizations. The world found that machines generated data that could be transformed into valuable insights. This was the origin of what is today called the data lakehouse. The evolution of data architecture continues today.
Come listen to industry experts describe this transformation of ordinary data into a data architecture that is invaluable to business. Simply put, organizations that take data architecture seriously are going to be at the forefront of business tomorrow.
This is an educational event.
Several of the authors of the book Building the Data Lakehouse will be presenting at this symposium.
The world of data architecture began with applications. Next came data warehouses. Then text was organized into a data warehouse.
Then one day the world discovered a whole new kind of data that was being generated by organizations. The world found that machines generated data that could be transformed into valuable insights. This was the origin of what is today called the data lakehouse. The evolution of data architecture continues today.
Come listen to industry experts describe this transformation of ordinary data into a data architecture that is invaluable to business. Simply put, organizations that take data architecture seriously are going to be at the forefront of business tomorrow.
This is an educational event.
Several of the authors of the book Building the Data Lakehouse will be presenting at this symposium.
The world of data architecture began with applications. Next came data warehouses. Then text was organized into a data warehouse.
Then one day the world discovered a whole new kind of data that was being generated by organizations. The world found that machines generated data that could be transformed into valuable insights. This was the origin of what is today called the data lakehouse. The evolution of data architecture continues today.
Come listen to industry experts describe this transformation of ordinary data into a data architecture that is invaluable to business. Simply put, organizations that take data architecture seriously are going to be at the forefront of business tomorrow.
This is an educational event.
Several of the authors of the book Building the Data Lakehouse will be presenting at this symposium.
5 Critical Steps to Clean Your Data Swamp When Migrating Off of HadoopDatabricks
In this session, learn how to quickly supplement your on-premises Hadoop environment with a simple, open, and collaborative cloud architecture that enables you to generate greater value with scaled application of analytics and AI on all your data. You will also learn five critical steps for a successful migration to the Databricks Lakehouse Platform along with the resources available to help you begin to re-skill your data teams.
Democratizing Data Quality Through a Centralized PlatformDatabricks
Bad data leads to bad decisions and broken customer experiences. Organizations depend on complete and accurate data to power their business, maintain efficiency, and uphold customer trust. With thousands of datasets and pipelines running, how do we ensure that all data meets quality standards, and that expectations are clear between producers and consumers? Investing in shared, flexible components and practices for monitoring data health is crucial for a complex data organization to rapidly and effectively scale.
At Zillow, we built a centralized platform to meet our data quality needs across stakeholders. The platform is accessible to engineers, scientists, and analysts, and seamlessly integrates with existing data pipelines and data discovery tools. In this presentation, we will provide an overview of our platform’s capabilities, including:
Giving producers and consumers the ability to define and view data quality expectations using a self-service onboarding portal
Performing data quality validations using libraries built to work with spark
Dynamically generating pipelines that can be abstracted away from users
Flagging data that doesn’t meet quality standards at the earliest stage and giving producers the opportunity to resolve issues before use by downstream consumers
Exposing data quality metrics alongside each dataset to provide producers and consumers with a comprehensive picture of health over time
Learn to Use Databricks for Data ScienceDatabricks
Data scientists face numerous challenges throughout the data science workflow that hinder productivity. As organizations continue to become more data-driven, a collaborative environment is more critical than ever — one that provides easier access and visibility into the data, reports and dashboards built against the data, reproducibility, and insights uncovered within the data.. Join us to hear how Databricks’ open and collaborative platform simplifies data science by enabling you to run all types of analytics workloads, from data preparation to exploratory analysis and predictive analytics, at scale — all on one unified platform.
Why APM Is Not the Same As ML MonitoringDatabricks
Application performance monitoring (APM) has become the cornerstone of software engineering allowing engineering teams to quickly identify and remedy production issues. However, as the world moves to intelligent software applications that are built using machine learning, traditional APM quickly becomes insufficient to identify and remedy production issues encountered in these modern software applications.
As a lead software engineer at NewRelic, my team built high-performance monitoring systems including Insights, Mobile, and SixthSense. As I transitioned to building ML Monitoring software, I found the architectural principles and design choices underlying APM to not be a good fit for this brand new world. In fact, blindly following APM designs led us down paths that would have been better left unexplored.
In this talk, I draw upon my (and my team’s) experience building an ML Monitoring system from the ground up and deploying it on customer workloads running large-scale ML training with Spark as well as real-time inference systems. I will highlight how the key principles and architectural choices of APM don’t apply to ML monitoring. You’ll learn why, understand what ML Monitoring can successfully borrow from APM, and hear what is required to build a scalable, robust ML Monitoring architecture.
The Function, the Context, and the Data—Enabling ML Ops at Stitch FixDatabricks
Autonomy and ownership are core to working at Stitch Fix, particularly on the Algorithms team. We enable data scientists to deploy and operate their models independently, with minimal need for handoffs or gatekeeping. By writing a simple function and calling out to an intuitive API, data scientists can harness a suite of platform-provided tooling meant to make ML operations easy. In this talk, we will dive into the abstractions the Data Platform team has built to enable this. We will go over the interface data scientists use to specify a model and what that hooks into, including online deployment, batch execution on Spark, and metrics tracking and visualization.
Stage Level Scheduling Improving Big Data and AI IntegrationDatabricks
In this talk, I will dive into the stage level scheduling feature added to Apache Spark 3.1. Stage level scheduling extends upon Project Hydrogen by improving big data ETL and AI integration and also enables multiple other use cases. It is beneficial any time the user wants to change container resources between stages in a single Apache Spark application, whether those resources are CPU, Memory or GPUs. One of the most popular use cases is enabling end-to-end scalable Deep Learning and AI to efficiently use GPU resources. In this type of use case, users read from a distributed file system, do data manipulation and filtering to get the data into a format that the Deep Learning algorithm needs for training or inference and then sends the data into a Deep Learning algorithm. Using stage level scheduling combined with accelerator aware scheduling enables users to seamlessly go from ETL to Deep Learning running on the GPU by adjusting the container requirements for different stages in Spark within the same application. This makes writing these applications easier and can help with hardware utilization and costs.
There are other ETL use cases where users want to change CPU and memory resources between stages, for instance there is data skew or perhaps the data size is much larger in certain stages of the application. In this talk, I will go over the feature details, cluster requirements, the API and use cases. I will demo how the stage level scheduling API can be used by Horovod to seamlessly go from data preparation to training using the Tensorflow Keras API using GPUs.
The talk will also touch on other new Apache Spark 3.1 functionality, such as pluggable caching, which can be used to enable faster dataframe access when operating from GPUs.
Simplify Data Conversion from Spark to TensorFlow and PyTorchDatabricks
In this talk, I would like to introduce an open-source tool built by our team that simplifies the data conversion from Apache Spark to deep learning frameworks.
Imagine you have a large dataset, say 20 GBs, and you want to use it to train a TensorFlow model. Before feeding the data to the model, you need to clean and preprocess your data using Spark. Now you have your dataset in a Spark DataFrame. When it comes to the training part, you may have the problem: How can I convert my Spark DataFrame to some format recognized by my TensorFlow model?
The existing data conversion process can be tedious. For example, to convert an Apache Spark DataFrame to a TensorFlow Dataset file format, you need to either save the Apache Spark DataFrame on a distributed filesystem in parquet format and load the converted data with third-party tools such as Petastorm, or save it directly in TFRecord files with spark-tensorflow-connector and load it back using TFRecordDataset. Both approaches take more than 20 lines of code to manage the intermediate data files, rely on different parsing syntax, and require extra attention for handling vector columns in the Spark DataFrames. In short, all these engineering frictions greatly reduced the data scientists’ productivity.
The Databricks Machine Learning team contributed a new Spark Dataset Converter API to Petastorm to simplify these tedious data conversion process steps. With the new API, it takes a few lines of code to convert a Spark DataFrame to a TensorFlow Dataset or a PyTorch DataLoader with default parameters.
In the talk, I will use an example to show how to use the Spark Dataset Converter to train a Tensorflow model and how simple it is to go from single-node training to distributed training on Databricks.
Scaling your Data Pipelines with Apache Spark on KubernetesDatabricks
There is no doubt Kubernetes has emerged as the next generation of cloud native infrastructure to support a wide variety of distributed workloads. Apache Spark has evolved to run both Machine Learning and large scale analytics workloads. There is growing interest in running Apache Spark natively on Kubernetes. By combining the flexibility of Kubernetes and scalable data processing with Apache Spark, you can run any data and machine pipelines on this infrastructure while effectively utilizing resources at disposal.
In this talk, Rajesh Thallam and Sougata Biswas will share how to effectively run your Apache Spark applications on Google Kubernetes Engine (GKE) and Google Cloud Dataproc, orchestrate the data and machine learning pipelines with managed Apache Airflow on GKE (Google Cloud Composer). Following topics will be covered: – Understanding key traits of Apache Spark on Kubernetes- Things to know when running Apache Spark on Kubernetes such as autoscaling- Demonstrate running analytics pipelines on Apache Spark orchestrated with Apache Airflow on Kubernetes cluster.
Scaling and Unifying SciKit Learn and Apache Spark PipelinesDatabricks
Pipelines have become ubiquitous, as the need for stringing multiple functions to compose applications has gained adoption and popularity. Common pipeline abstractions such as “fit” and “transform” are even shared across divergent platforms such as Python Scikit-Learn and Apache Spark.
Scaling pipelines at the level of simple functions is desirable for many AI applications, however is not directly supported by Ray’s parallelism primitives. In this talk, Raghu will describe a pipeline abstraction that takes advantage of Ray’s compute model to efficiently scale arbitrarily complex pipeline workflows. He will demonstrate how this abstraction cleanly unifies pipeline workflows across multiple platforms such as Scikit-Learn and Spark, and achieves nearly optimal scale-out parallelism on pipelined computations.
Attendees will learn how pipelined workflows can be mapped to Ray’s compute model and how they can both unify and accelerate their pipelines with Ray.
Sawtooth Windows for Feature AggregationsDatabricks
In this talk about zipline, we will introduce a new type of windowing construct called a sawtooth window. We will describe various properties about sawtooth windows that we utilize to achieve online-offline consistency, while still maintaining high-throughput, low-read latency and tunable write latency for serving machine learning features.We will also talk about a simple deployment strategy for correcting feature drift – due operations that are not “abelian groups”, that operate over change data.
We want to present multiple anti patterns utilizing Redis in unconventional ways to get the maximum out of Apache Spark.All examples presented are tried and tested in production at Scale at Adobe. The most common integration is spark-redis which interfaces with Redis as a Dataframe backing Store or as an upstream for Structured Streaming. We deviate from the common use cases to explore where Redis can plug gaps while scaling out high throughput applications in Spark.
Niche 1 : Long Running Spark Batch Job – Dispatch New Jobs by polling a Redis Queue
· Why?
o Custom queries on top a table; We load the data once and query N times
· Why not Structured Streaming
· Working Solution using Redis
Niche 2 : Distributed Counters
· Problems with Spark Accumulators
· Utilize Redis Hashes as distributed counters
· Precautions for retries and speculative execution
· Pipelining to improve performance
Re-imagine Data Monitoring with whylogs and SparkDatabricks
In the era of microservices, decentralized ML architectures and complex data pipelines, data quality has become a bigger challenge than ever. When data is involved in complex business processes and decisions, bad data can, and will, affect the bottom line. As a result, ensuring data quality across the entire ML pipeline is both costly, and cumbersome while data monitoring is often fragmented and performed ad hoc. To address these challenges, we built whylogs, an open source standard for data logging. It is a lightweight data profiling library that enables end-to-end data profiling across the entire software stack. The library implements a language and platform agnostic approach to data quality and data monitoring. It can work with different modes of data operations, including streaming, batch and IoT data.
In this talk, we will provide an overview of the whylogs architecture, including its lightweight statistical data collection approach and various integrations. We will demonstrate how the whylogs integration with Apache Spark achieves large scale data profiling, and we will show how users can apply this integration into existing data and ML pipelines.
Raven: End-to-end Optimization of ML Prediction QueriesDatabricks
Machine learning (ML) models are typically part of prediction queries that consist of a data processing part (e.g., for joining, filtering, cleaning, featurization) and an ML part invoking one or more trained models. In this presentation, we identify significant and unexplored opportunities for optimization. To the best of our knowledge, this is the first effort to look at prediction queries holistically, optimizing across both the ML and SQL components.
We will present Raven, an end-to-end optimizer for prediction queries. Raven relies on a unified intermediate representation that captures both data processing and ML operators in a single graph structure.
This allows us to introduce optimization rules that
(i) reduce unnecessary computations by passing information between the data processing and ML operators
(ii) leverage operator transformations (e.g., turning a decision tree to a SQL expression or an equivalent neural network) to map operators to the right execution engine, and
(iii) integrate compiler techniques to take advantage of the most efficient hardware backend (e.g., CPU, GPU) for each operator.
We have implemented Raven as an extension to Spark’s Catalyst optimizer to enable the optimization of SparkSQL prediction queries. Our implementation also allows the optimization of prediction queries in SQL Server. As we will show, Raven is capable of improving prediction query performance on Apache Spark and SQL Server by up to 13.1x and 330x, respectively. For complex models, where GPU acceleration is beneficial, Raven provides up to 8x speedup compared to state-of-the-art systems. As part of the presentation, we will also give a demo showcasing Raven in action.
Processing Large Datasets for ADAS Applications using Apache SparkDatabricks
Semantic segmentation is the classification of every pixel in an image/video. The segmentation partitions a digital image into multiple objects to simplify/change the representation of the image into something that is more meaningful and easier to analyze [1][2]. The technique has a wide variety of applications ranging from perception in autonomous driving scenarios to cancer cell segmentation for medical diagnosis.
Exponential growth in the datasets that require such segmentation is driven by improvements in the accuracy and quality of the sensors generating the data extending to 3D point cloud data. This growth is further compounded by exponential advances in cloud technologies enabling the storage and compute available for such applications. The need for semantically segmented datasets is a key requirement to improve the accuracy of inference engines that are built upon them.
Streamlining the accuracy and efficiency of these systems directly affects the value of the business outcome for organizations that are developing such functionalities as a part of their AI strategy.
This presentation details workflows for labeling, preprocessing, modeling, and evaluating performance/accuracy. Scientists and engineers leverage domain-specific features/tools that support the entire workflow from labeling the ground truth, handling data from a wide variety of sources/formats, developing models and finally deploying these models. Users can scale their deployments optimally on GPU-based cloud infrastructure to build accelerated training and inference pipelines while working with big datasets. These environments are optimized for engineers to develop such functionality with ease and then scale against large datasets with Spark-based clusters on the cloud.
Massive Data Processing in Adobe Using Delta LakeDatabricks
At Adobe Experience Platform, we ingest TBs of data every day and manage PBs of data for our customers as part of the Unified Profile Offering. At the heart of this is a bunch of complex ingestion of a mix of normalized and denormalized data with various linkage scenarios power by a central Identity Linking Graph. This helps power various marketing scenarios that are activated in multiple platforms and channels like email, advertisements etc. We will go over how we built a cost effective and scalable data pipeline using Apache Spark and Delta Lake and share our experiences.
What are we storing?
Multi Source – Multi Channel Problem
Data Representation and Nested Schema Evolution
Performance Trade Offs with Various formats
Go over anti-patterns used
(String FTW)
Data Manipulation using UDFs
Writer Worries and How to Wipe them Away
Staging Tables FTW
Datalake Replication Lag Tracking
Performance Time!
Chatty Kathy - UNC Bootcamp Final Project Presentation - Final Version - 5.23...John Andrews
SlideShare Description for "Chatty Kathy - UNC Bootcamp Final Project Presentation"
Title: Chatty Kathy: Enhancing Physical Activity Among Older Adults
Description:
Discover how Chatty Kathy, an innovative project developed at the UNC Bootcamp, aims to tackle the challenge of low physical activity among older adults. Our AI-driven solution uses peer interaction to boost and sustain exercise levels, significantly improving health outcomes. This presentation covers our problem statement, the rationale behind Chatty Kathy, synthetic data and persona creation, model performance metrics, a visual demonstration of the project, and potential future developments. Join us for an insightful Q&A session to explore the potential of this groundbreaking project.
Project Team: Jay Requarth, Jana Avery, John Andrews, Dr. Dick Davis II, Nee Buntoum, Nam Yeongjin & Mat Nicholas
As Europe's leading economic powerhouse and the fourth-largest hashtag#economy globally, Germany stands at the forefront of innovation and industrial might. Renowned for its precision engineering and high-tech sectors, Germany's economic structure is heavily supported by a robust service industry, accounting for approximately 68% of its GDP. This economic clout and strategic geopolitical stance position Germany as a focal point in the global cyber threat landscape.
In the face of escalating global tensions, particularly those emanating from geopolitical disputes with nations like hashtag#Russia and hashtag#China, hashtag#Germany has witnessed a significant uptick in targeted cyber operations. Our analysis indicates a marked increase in hashtag#cyberattack sophistication aimed at critical infrastructure and key industrial sectors. These attacks range from ransomware campaigns to hashtag#AdvancedPersistentThreats (hashtag#APTs), threatening national security and business integrity.
🔑 Key findings include:
🔍 Increased frequency and complexity of cyber threats.
🔍 Escalation of state-sponsored and criminally motivated cyber operations.
🔍 Active dark web exchanges of malicious tools and tactics.
Our comprehensive report delves into these challenges, using a blend of open-source and proprietary data collection techniques. By monitoring activity on critical networks and analyzing attack patterns, our team provides a detailed overview of the threats facing German entities.
This report aims to equip stakeholders across public and private sectors with the knowledge to enhance their defensive strategies, reduce exposure to cyber risks, and reinforce Germany's resilience against cyber threats.
Techniques to optimize the pagerank algorithm usually fall in two categories. One is to try reducing the work per iteration, and the other is to try reducing the number of iterations. These goals are often at odds with one another. Skipping computation on vertices which have already converged has the potential to save iteration time. Skipping in-identical vertices, with the same in-links, helps reduce duplicate computations and thus could help reduce iteration time. Road networks often have chains which can be short-circuited before pagerank computation to improve performance. Final ranks of chain nodes can be easily calculated. This could reduce both the iteration time, and the number of iterations. If a graph has no dangling nodes, pagerank of each strongly connected component can be computed in topological order. This could help reduce the iteration time, no. of iterations, and also enable multi-iteration concurrency in pagerank computation. The combination of all of the above methods is the STICD algorithm. [sticd] For dynamic graphs, unchanged components whose ranks are unaffected can be skipped altogether.
Explore our comprehensive data analysis project presentation on predicting product ad campaign performance. Learn how data-driven insights can optimize your marketing strategies and enhance campaign effectiveness. Perfect for professionals and students looking to understand the power of data analysis in advertising. for more details visit: https://bostoninstituteofanalytics.org/data-science-and-artificial-intelligence/
StarCompliance is a leading firm specializing in the recovery of stolen cryptocurrency. Our comprehensive services are designed to assist individuals and organizations in navigating the complex process of fraud reporting, investigation, and fund recovery. We combine cutting-edge technology with expert legal support to provide a robust solution for victims of crypto theft.
Our Services Include:
Reporting to Tracking Authorities:
We immediately notify all relevant centralized exchanges (CEX), decentralized exchanges (DEX), and wallet providers about the stolen cryptocurrency. This ensures that the stolen assets are flagged as scam transactions, making it impossible for the thief to use them.
Assistance with Filing Police Reports:
We guide you through the process of filing a valid police report. Our support team provides detailed instructions on which police department to contact and helps you complete the necessary paperwork within the critical 72-hour window.
Launching the Refund Process:
Our team of experienced lawyers can initiate lawsuits on your behalf and represent you in various jurisdictions around the world. They work diligently to recover your stolen funds and ensure that justice is served.
At StarCompliance, we understand the urgency and stress involved in dealing with cryptocurrency theft. Our dedicated team works quickly and efficiently to provide you with the support and expertise needed to recover your assets. Trust us to be your partner in navigating the complexities of the crypto world and safeguarding your investments.
3. About us
▪ PHD students from ADALab at UCSD, advised by
Prof. Arun Kumar
▪ Our research mission: democratize data science
▪ More:
Supun Nakandala
https://scnakandala.github.io/
Yuhao Zhang
https://yhzhang.info/
ADALab
https://adalabucsd.github.io/
5. Problem: training deep nets is Painful!
Batch size?
8, 16, 64, 256 ...
Model architecture?
3 layer CNN,5 layer
CNN, LSTM…
Learning rate?
0.1, 0.01, 0.001,
0.0001 ...
Regularization?
L2, L1, Dropout,
Batchnorm ...
4 4 4 4
256 Different configurations !
Model performance = f(model architecture, hyperparameters, ...)
→Trial and error
Need for speed → $$$
(Distributed DL)
→ Better utilization of resources

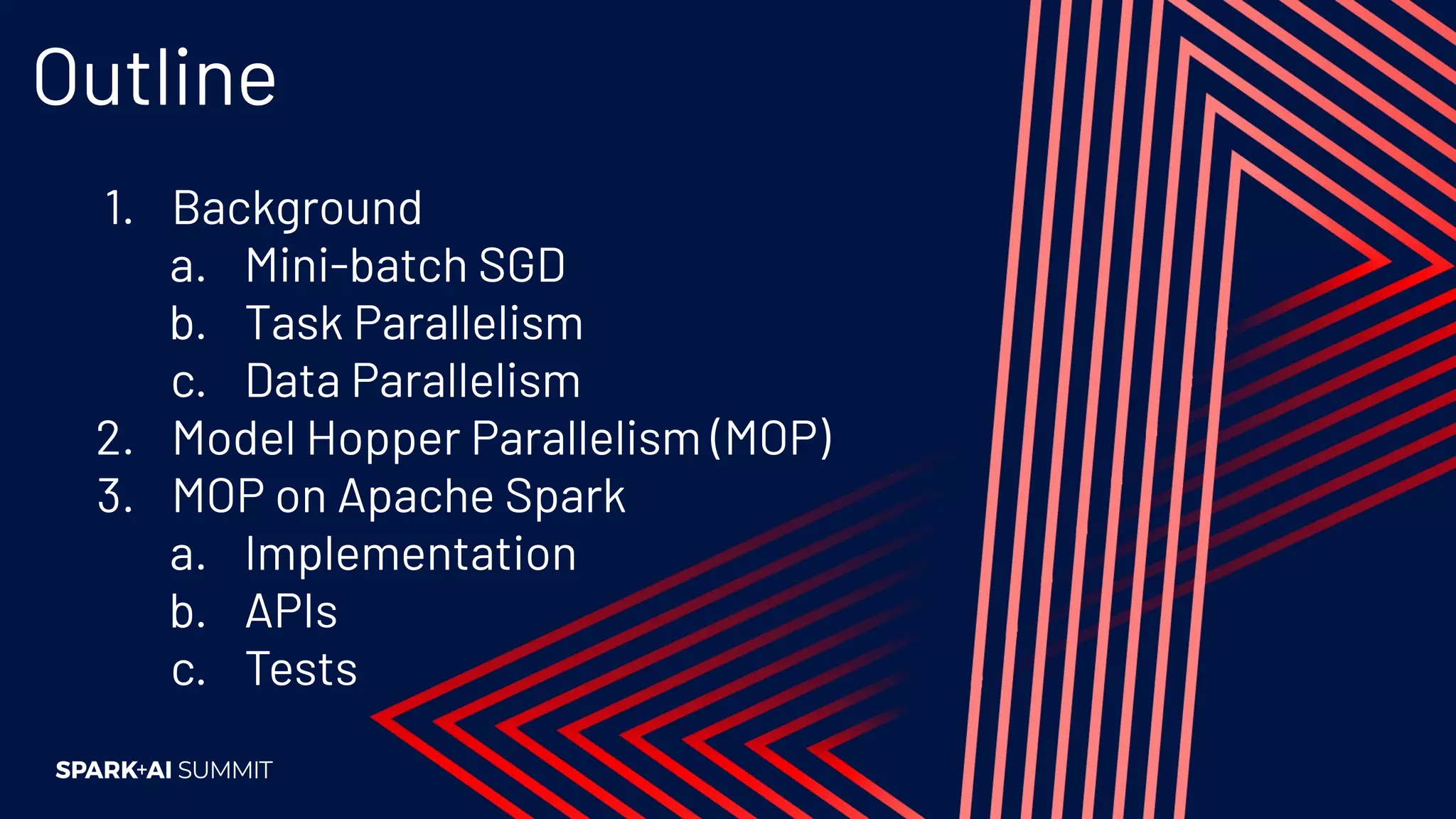

6. Outline
1. Background
a. Mini-batch SGD
b. Task Parallelism
c. Data Parallelism
2. Model Hopper Parallelism (MOP)
3. MOP on Apache Spark
a. Implementation
b. APIs
c. Tests
7. Outline
1. Background
a. Mini-batch SGD
b. Task Parallelism
c. Data Parallelism
2. Model Hopper Parallelism (MOP)
3. MOP on Apache Spark
a. Implementation
b. APIs
c. Tests

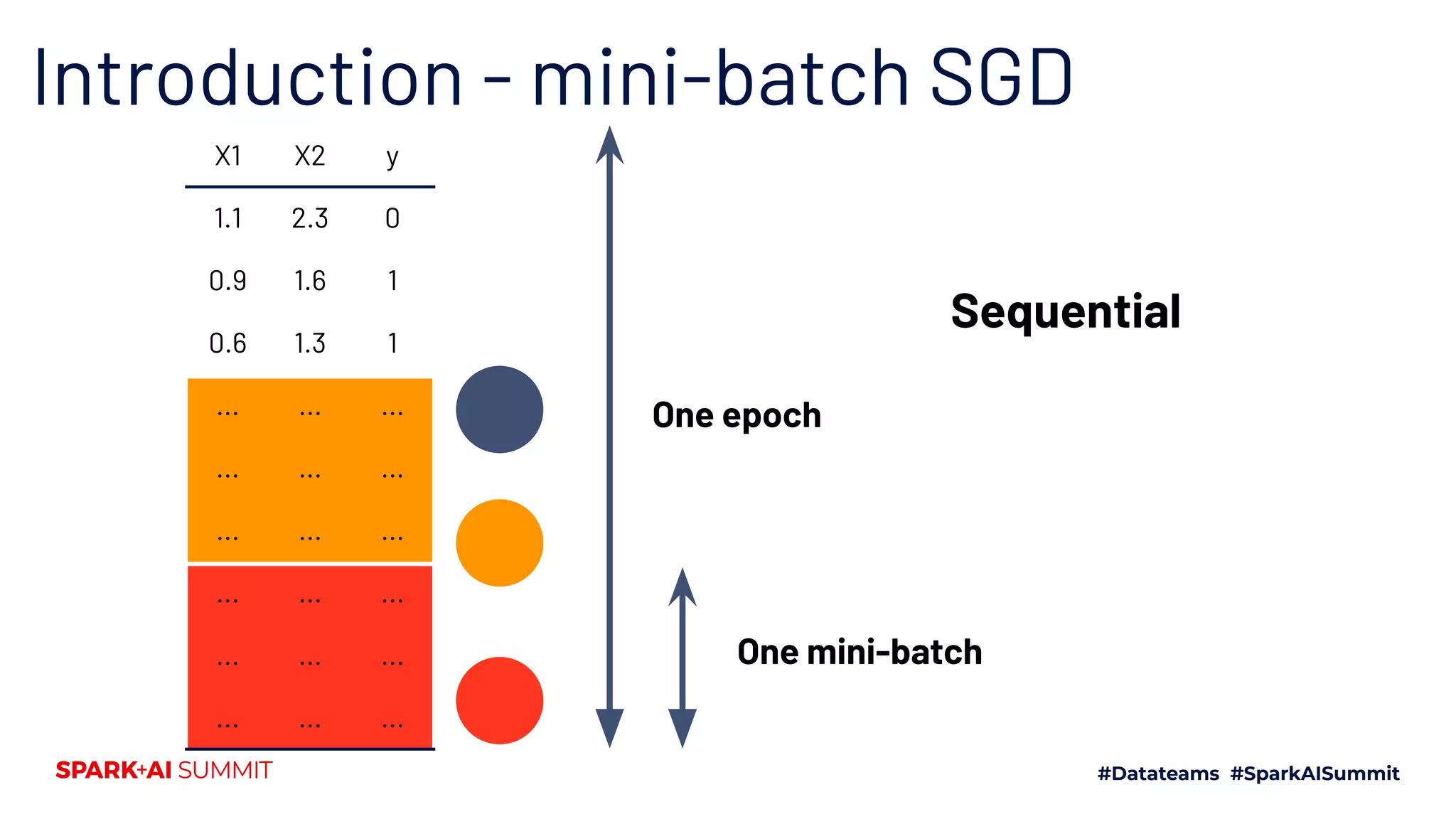

8. Introduction - mini-batch SGD
Model
Updated Model
η ∇
Learning
rate
Avg. of
gradients
X1 X2 y
1.1 2.3 0
0.9 1.6 1
0.6 1.3 1
... ... ...
... ... ...
... ... ...
... ... ...
... ... ...
... ... ...
One
mini-batch
The most popular algorithm family for
training deep nets
10. Outline
1. Background
a. Mini-batch SGD
b. Task Parallelism
c. Data Parallelism
2. Model Hopper Parallelism (MOP)
3. MOP on Apache Spark
a. Implementation
b. APIs
c. Tests
14. Outline
1. Background
a. Mini-batch SGD
b. Task Parallelism
c. Data Parallelism
2. Model Hopper Parallelism (MOP)
3. MOP on Apache Spark
a. Implementation
b. APIs
c. Tests

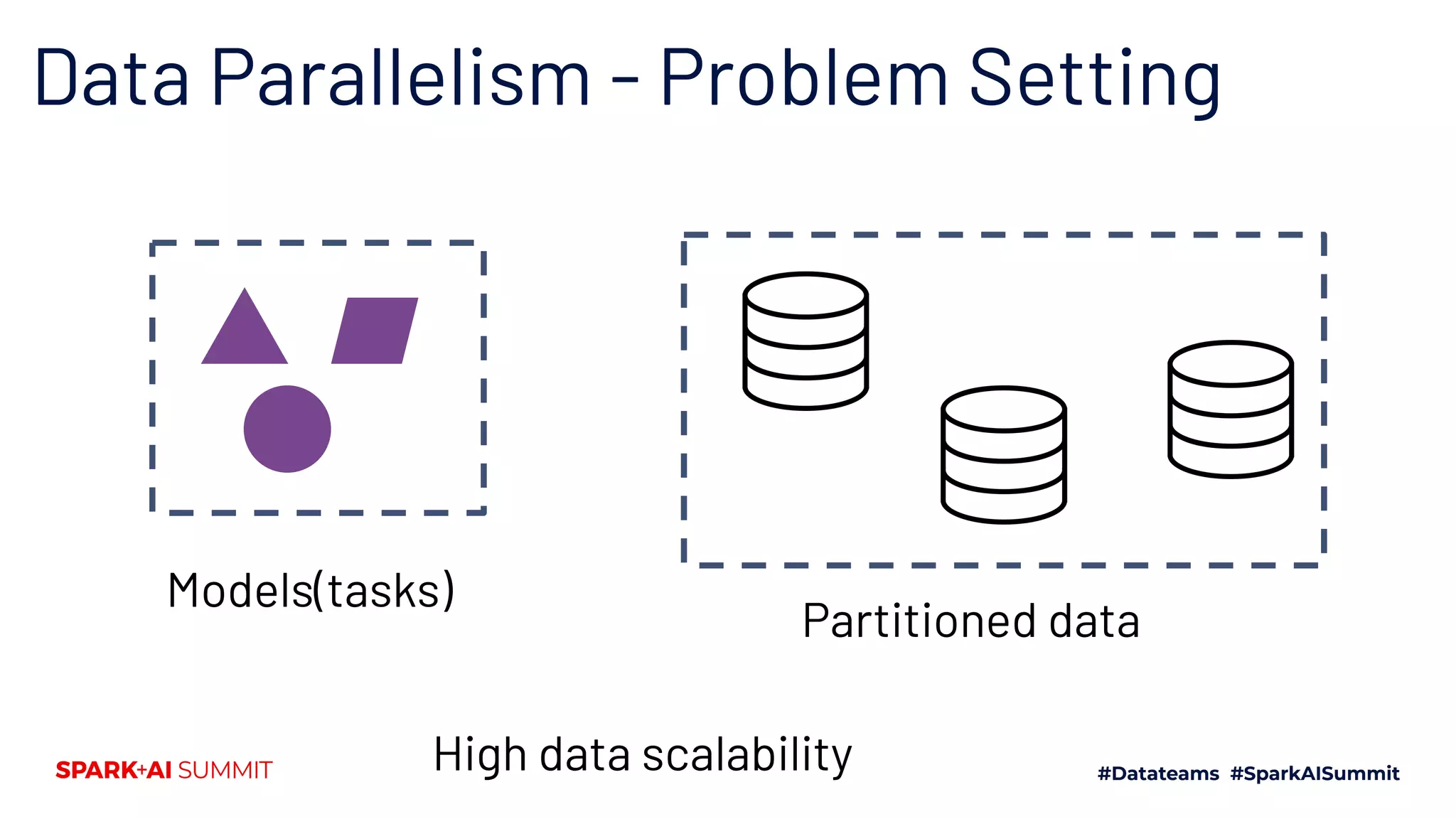

15. Data Parallelism - Problem Setting
Models(tasks)
Partitioned data
High data scalability
16. Data Parallelism
Queue
Training on one mini-batch
or full partition
● Update only per epoch: bulk synchronous parallelism
(model averaging)
○ Bad convergence
● Update per mini-batch: sync parameter server
○ + Async updates: async parameter server
○ + Decentralized: MPI allreduce (Horovod)
○ High communication cost
Updates

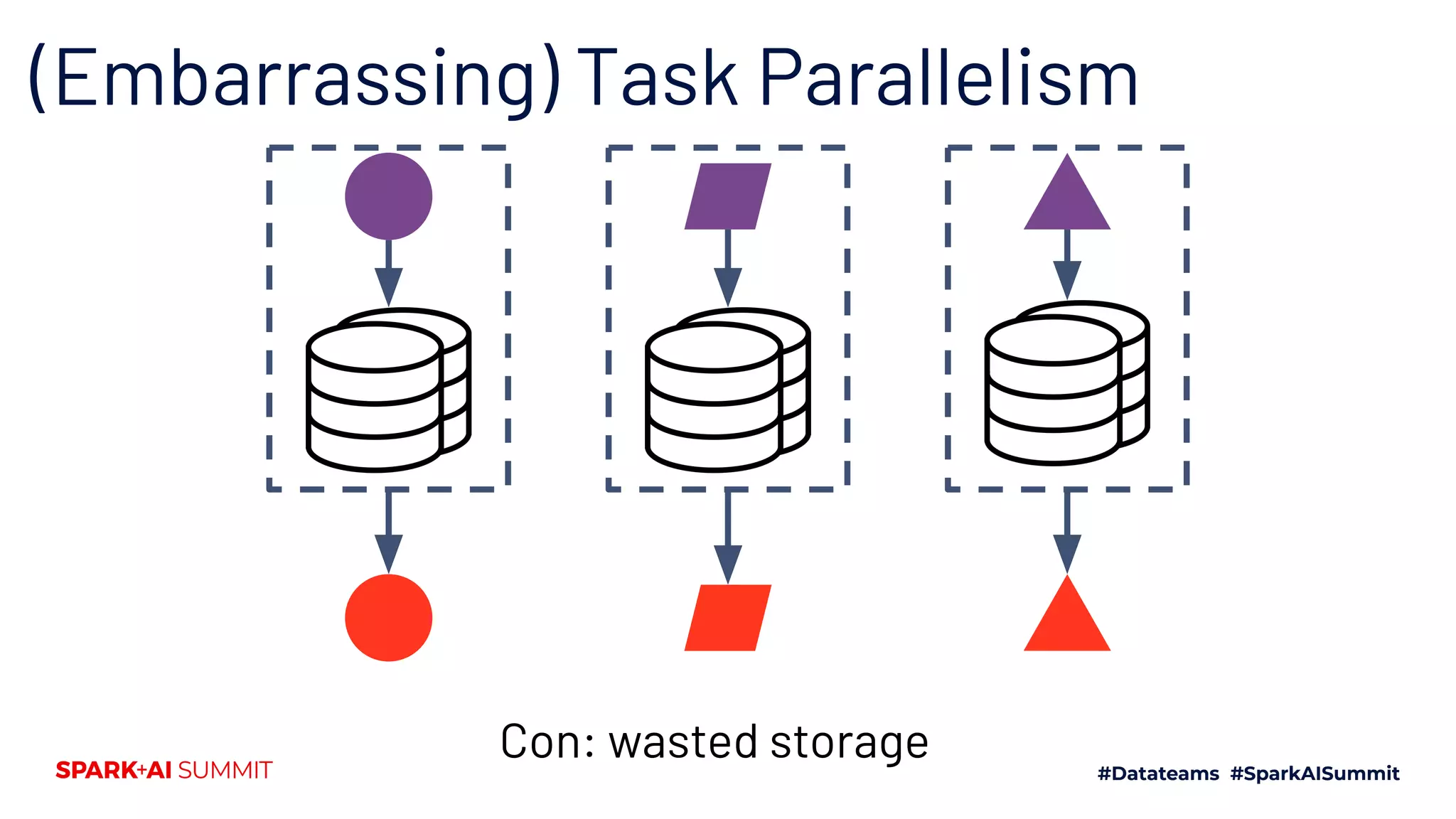

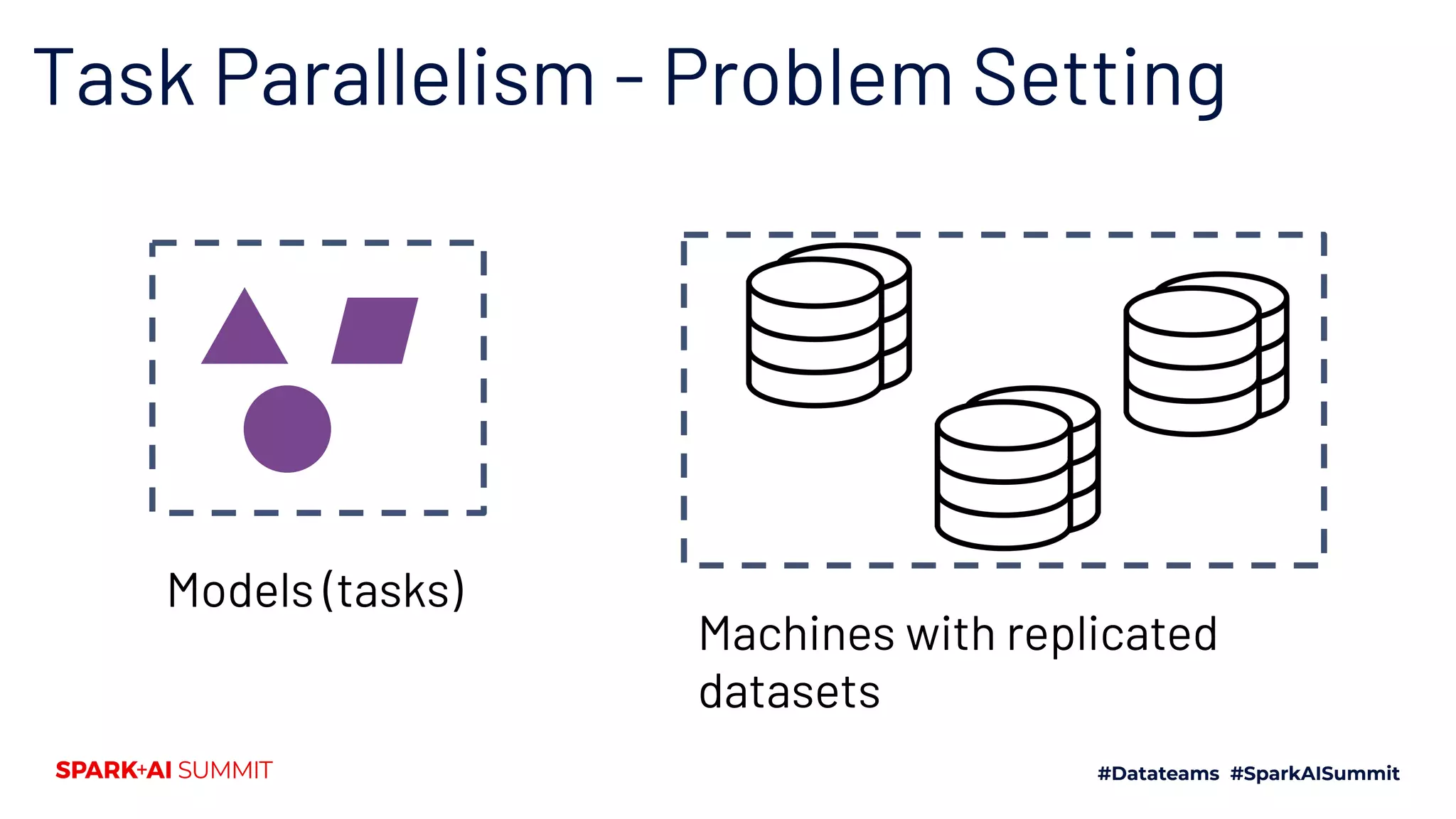

17. Task Parallelism
+ high throughput
- low data scalability
- memory/storage wastage
Data Parallelism
+ high data scalability
- low throughput
- high communication cost

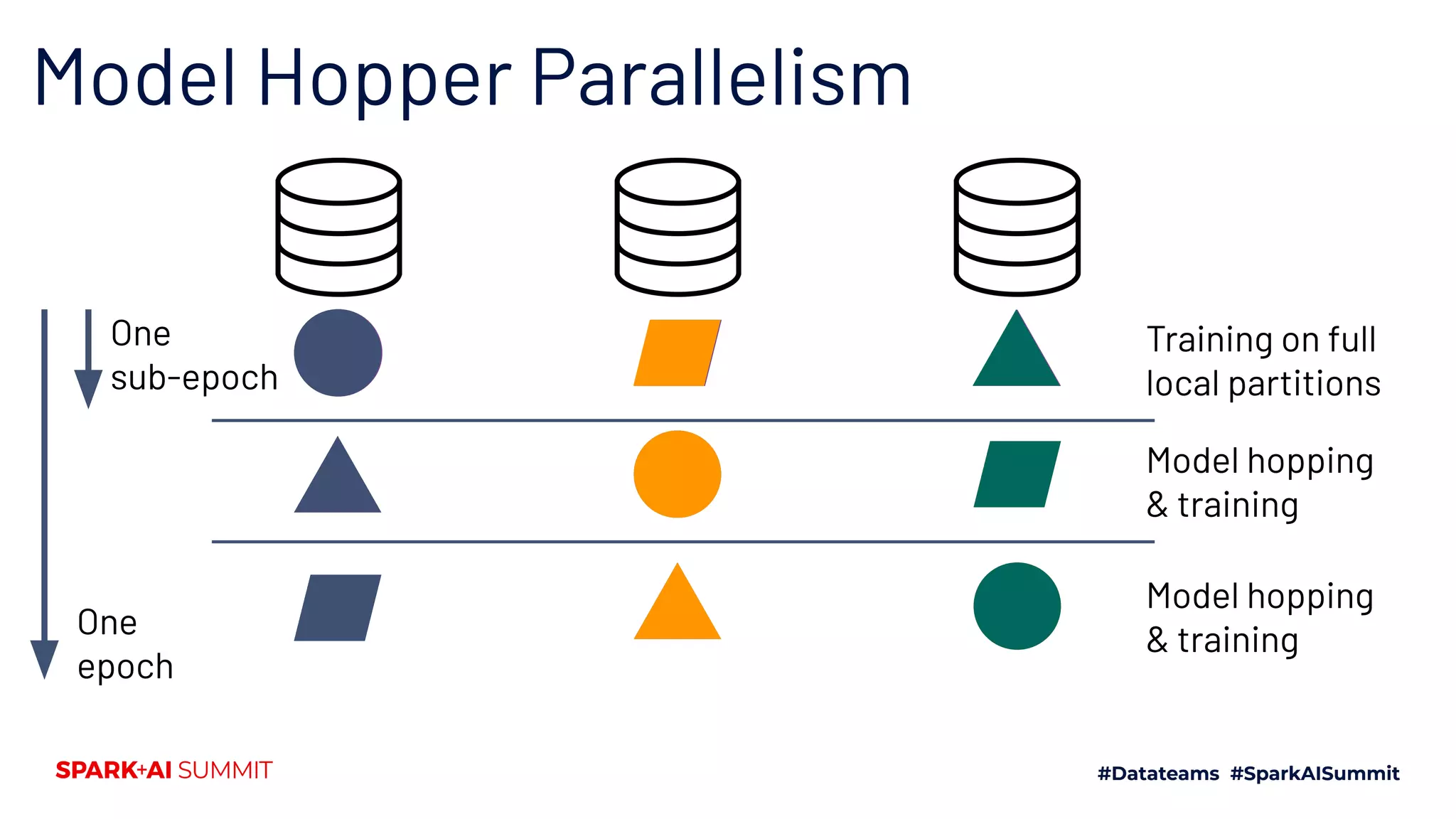

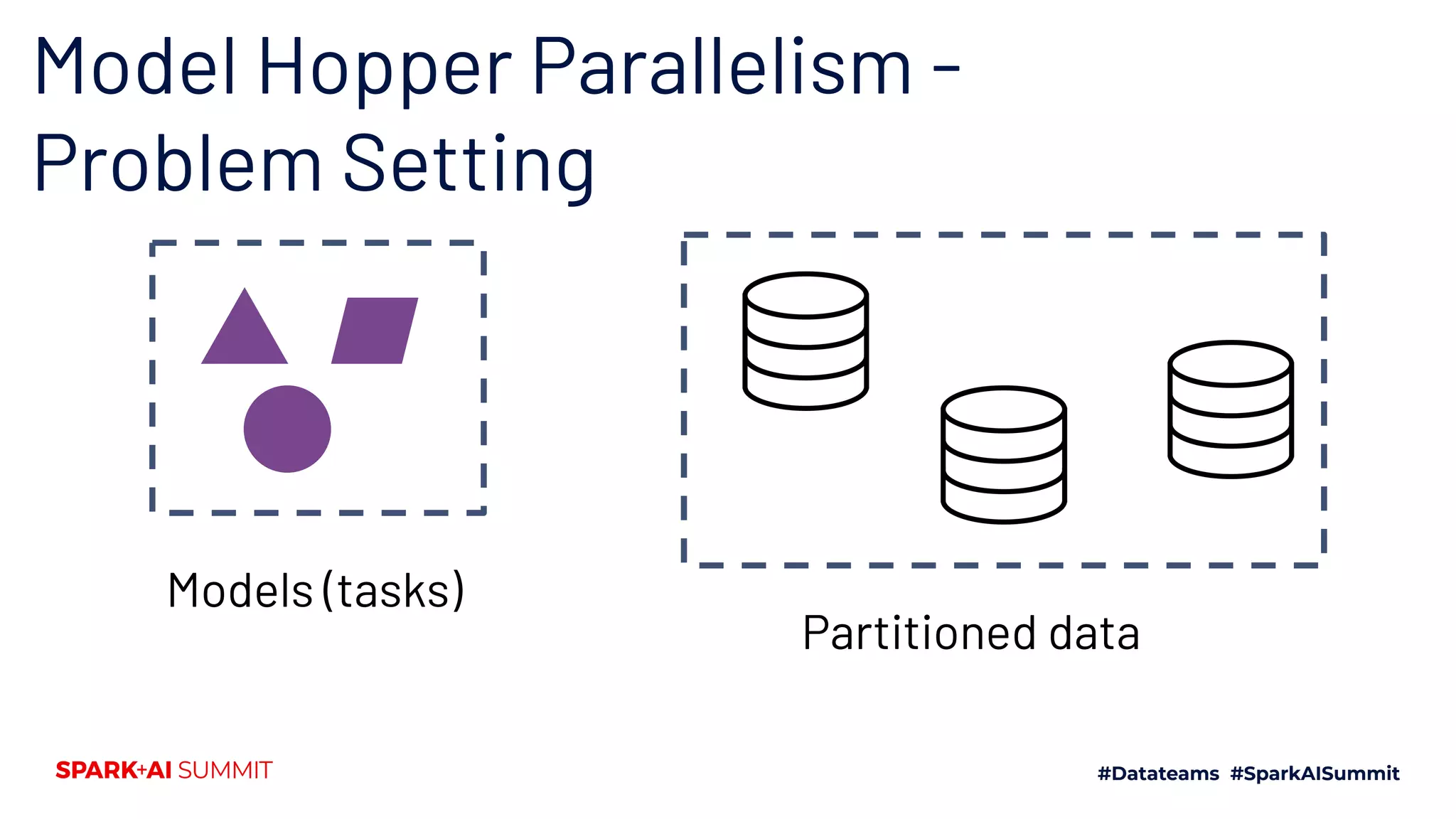

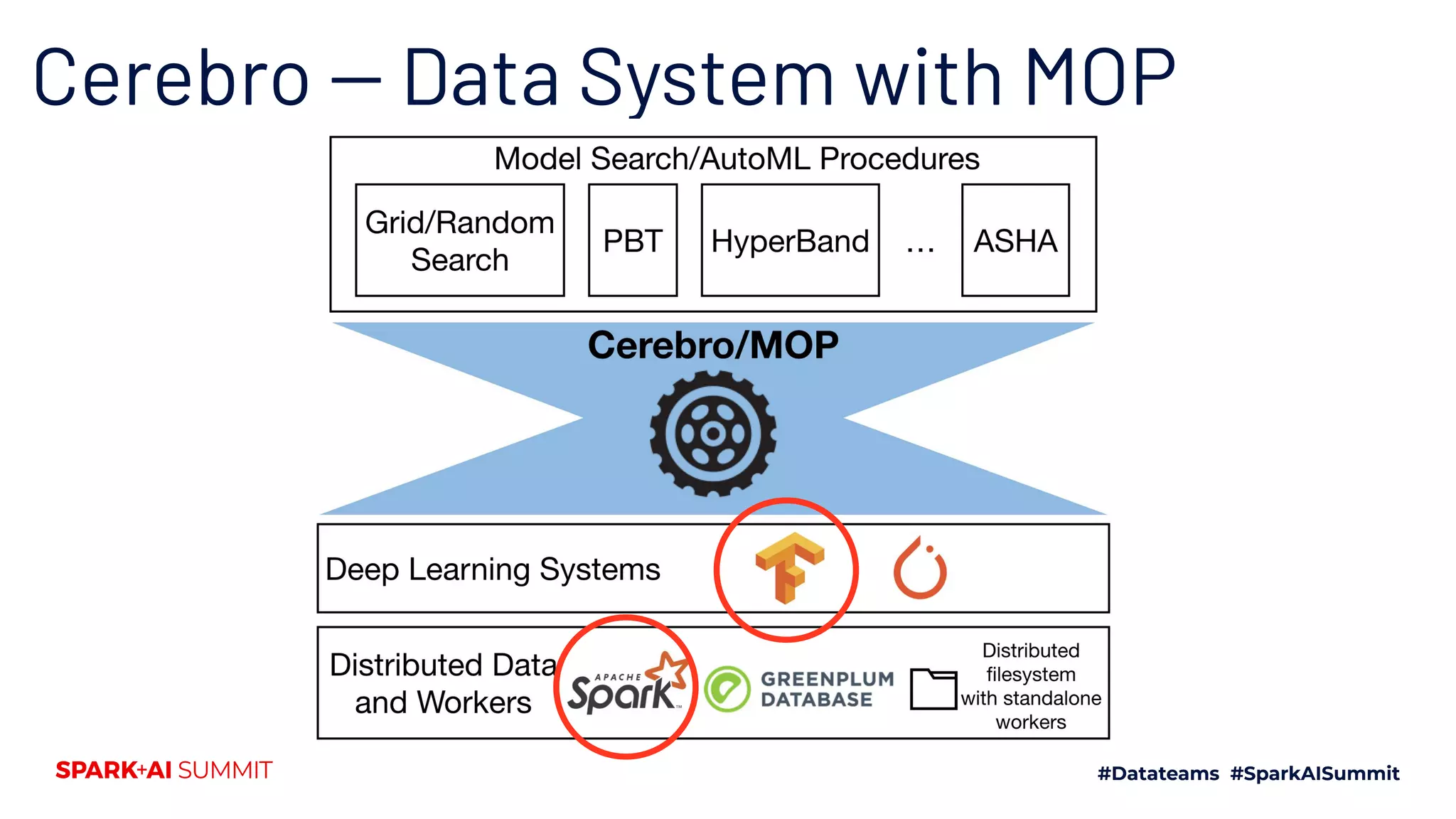

Model Hopper Parallelism (Cerebro)
+ high throughput
+ high data scalability
+ low communication cost

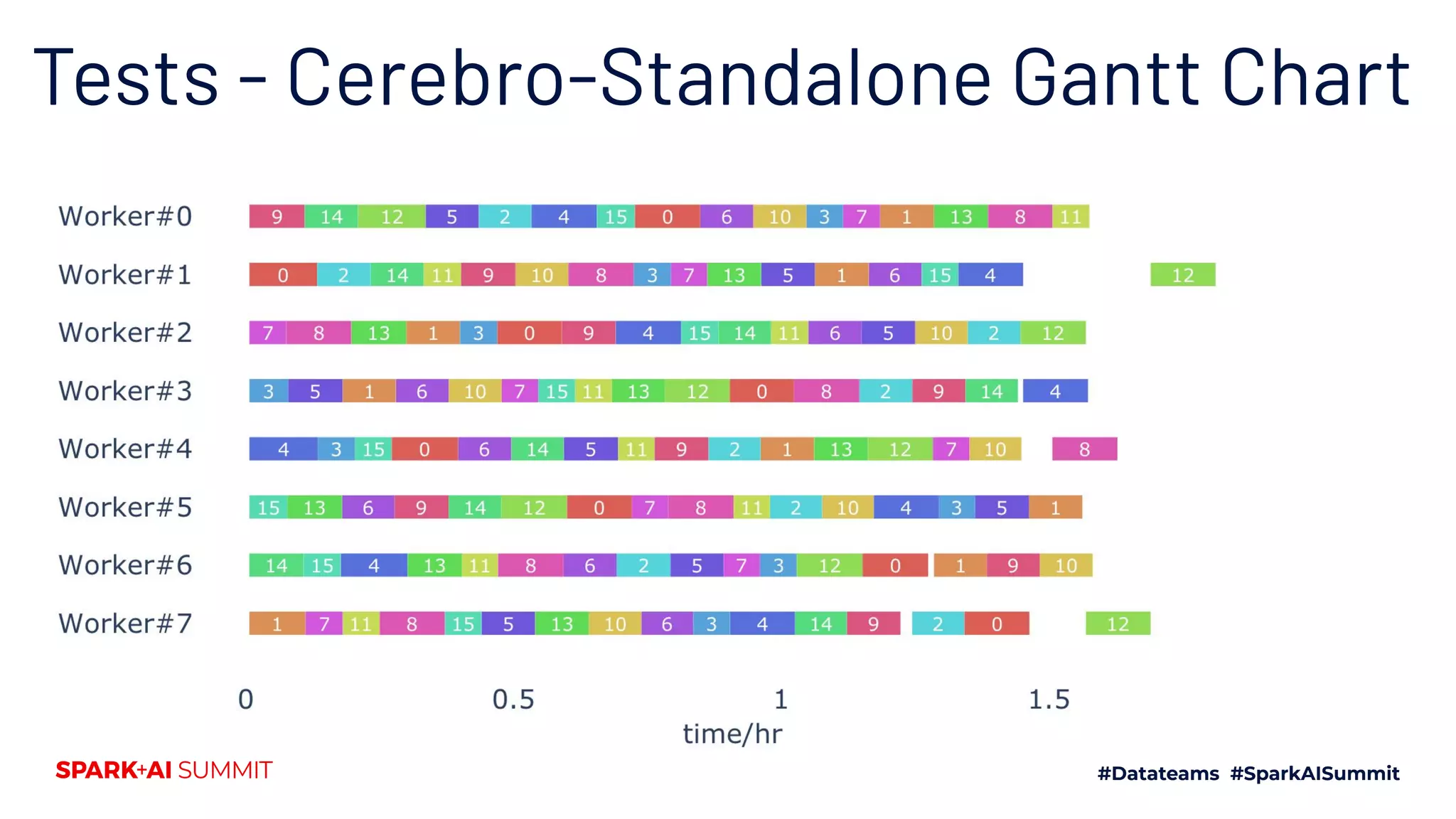

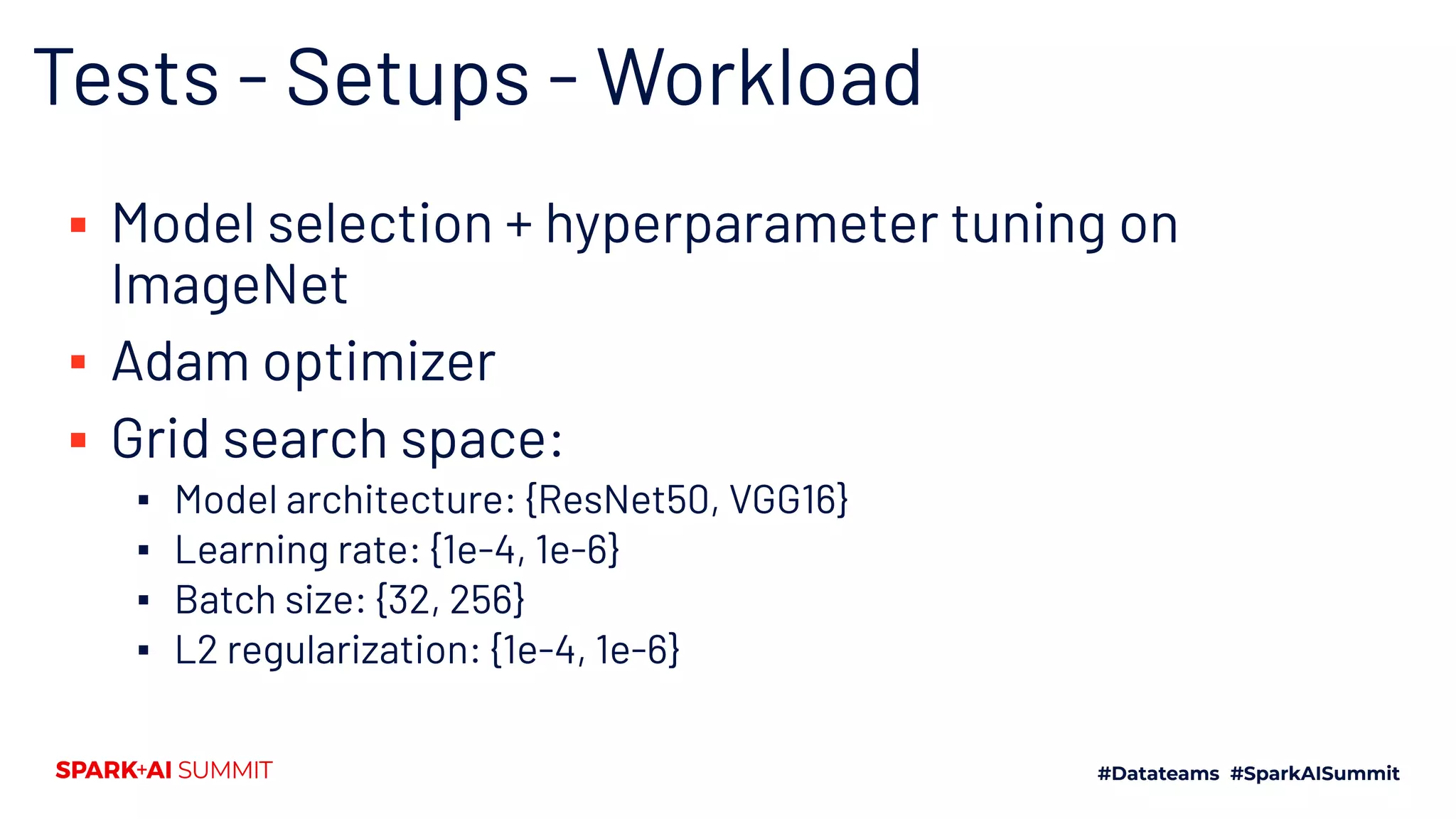

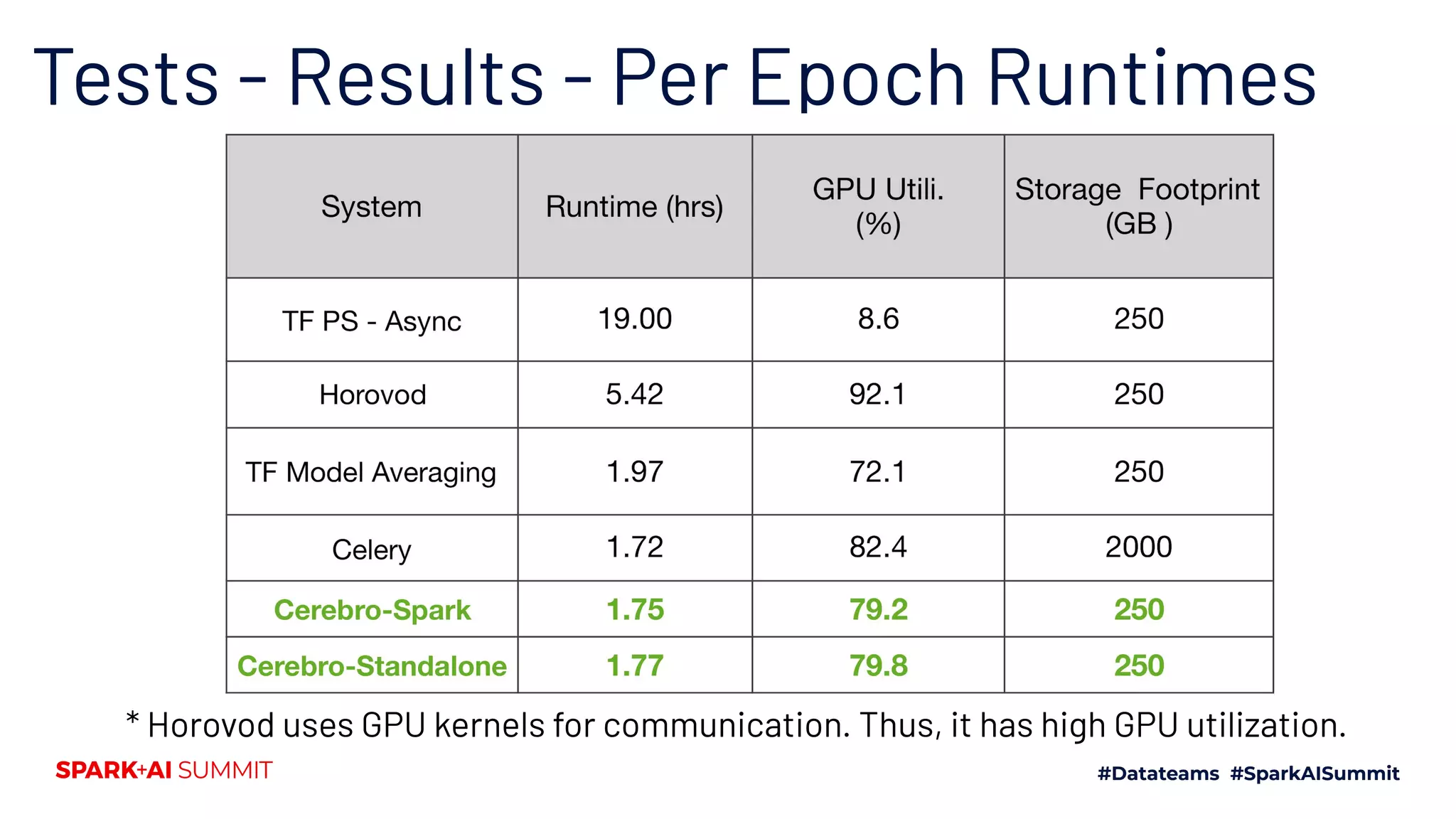

+ no memory/storage wastage
18. Outline
1. Background
a. Mini-batch SGD
b. Task Parallelism
c. Data Parallelism
2. Model Hopper Parallelism (MOP)
3. MOP on Apache Spark
a. Implementation
b. APIs
c. Tests
27. Outline
1. Background
a. Mini-batch SGD
b. Task Parallelism
c. Data Parallelism
2. Model Hopper Parallelism (MOP)
3. MOP on Apache Spark
a. Implementation
b. APIs
c. Tests
29. Implementation Details
▪ Spark DataFrames converted to partitioned Parquet
and locally cached in workers
▪ TensorFlow threads run training on local data
partitions
▪ Model Hopping implemented via shared file system
30. Outline
1. Background
a. Mini-batch SGD
b. Task Parallelism
c. Data Parallelism
2. Model Hopper Parallelism (MOP)
3. MOP on Apache Spark
a. Implementation
b. APIs
c. Tests
31. Example: Grid Search on
Model Selection + Hyperparameter
Search
▪ Two model architecture: {VGG16, ResNet50}
▪ Two learning rate: {1e-4, 1e-6}
▪ Two batch size: {32, 256}

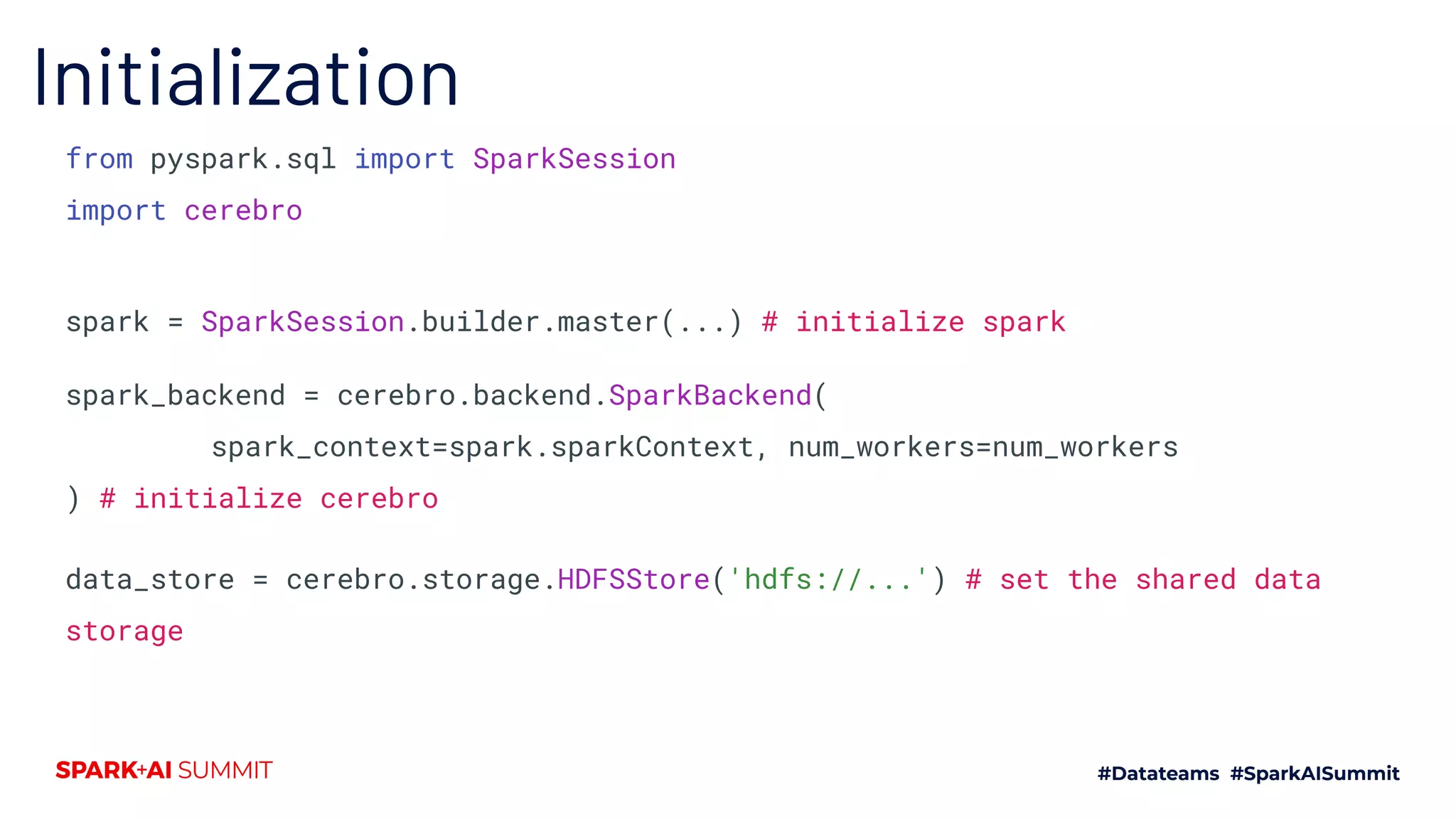

32. Initialization
from pyspark.sql import SparkSession
import cerebro
spark = SparkSession.builder.master(...) # initialize spark
spark_backend = cerebro.backend.SparkBackend(
spark_context=spark.sparkContext, num_workers=num_workers
) # initialize cerebro
data_store = cerebro.storage.HDFSStore('hdfs://...') # set the shared data
storage

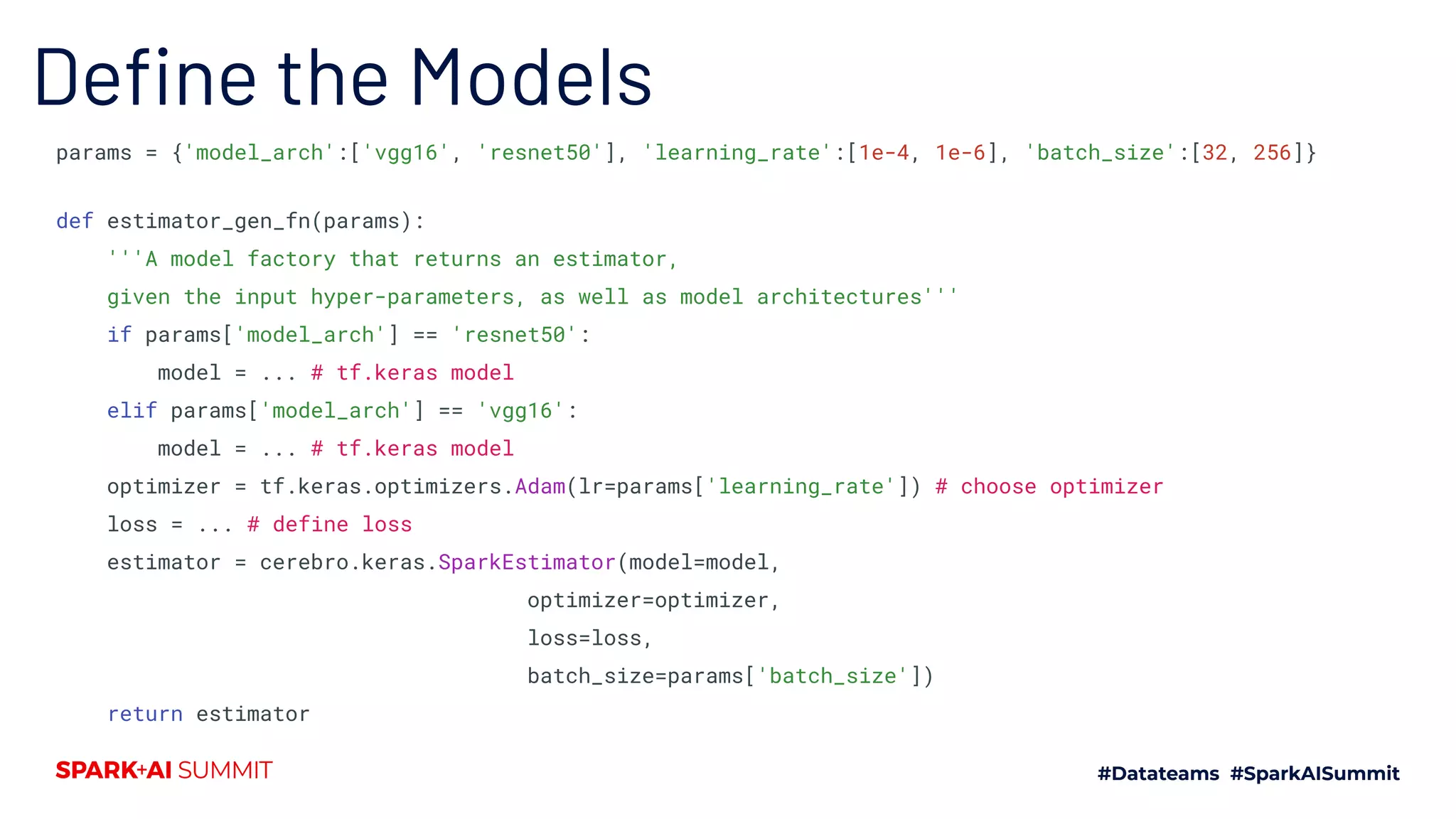

33. Define the Models
params = {'model_arch':['vgg16', 'resnet50'], 'learning_rate':[1e-4, 1e-6], 'batch_size':[32, 256]}
def estimator_gen_fn(params):
'''A model factory that returns an estimator,
given the input hyper-parameters, as well as model architectures'''
if params['model_arch'] == 'resnet50':
model = ... # tf.keras model
elif params['model_arch'] == 'vgg16':
model = ... # tf.keras model
optimizer = tf.keras.optimizers.Adam(lr=params['learning_rate']) # choose optimizer
loss = ... # define loss
estimator = cerebro.keras.SparkEstimator(model=model,
optimizer=optimizer,
loss=loss,
batch_size=params['batch_size'])
return estimator
34. Run Grid Search
df = ... # read data in as Spark DataFrame
grid_search = cerebro.tune.GridSearch(spark_backend,
data_store,
estimator_gen_fn,
params,
epoch=5,
validation=0.2,
feature_columns=['features'],
label_columns=['labels'])
model = grid_search.fit(df)
35. Outline
1. Background
a. Mini-batch SGD
b. Task Parallelism
c. Data Parallelism
2. Model Hopper Parallelism (MOP)
3. MOP on Apache Spark
a. Implementation
b. APIs
c. Tests

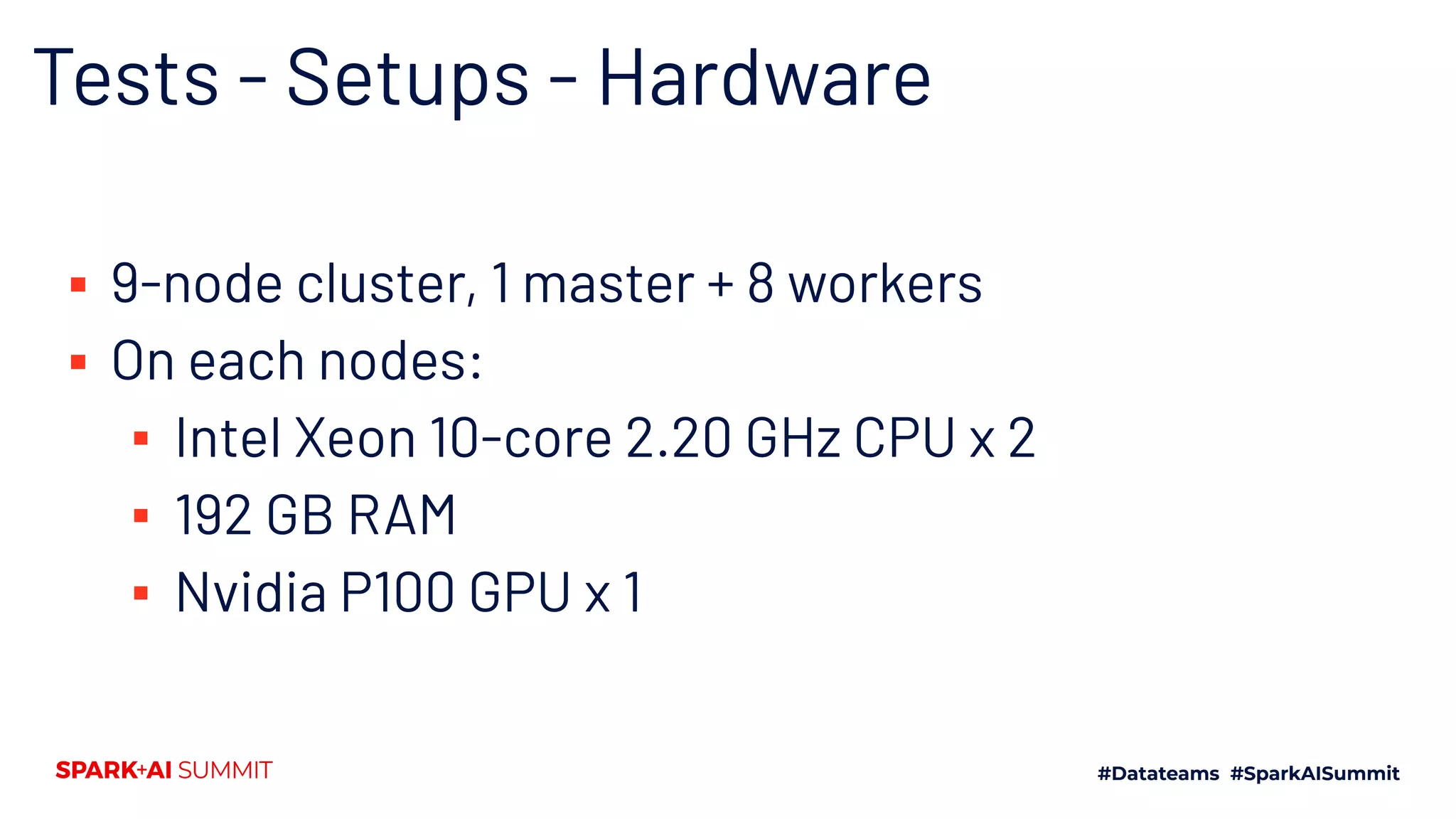

36. Tests - Setups - Hardware
▪ 9-node cluster, 1 master + 8 workers
▪ On each nodes:
▪ Intel Xeon 10-core 2.20 GHz CPU x 2
▪ 192 GB RAM
▪ Nvidia P100 GPU x 1

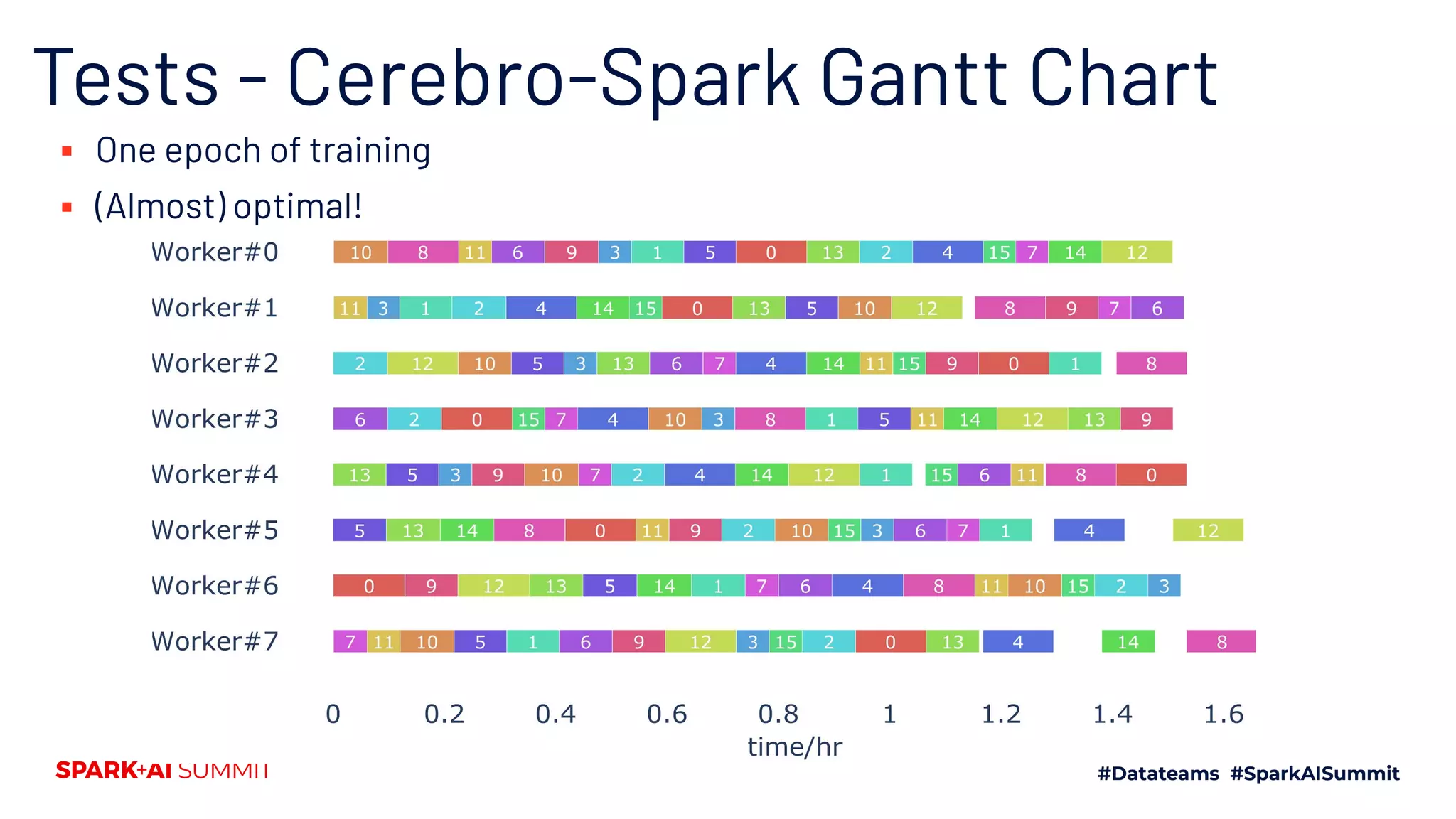

42. Tests - Cerebro-Spark Gantt Chart
▪ Only overhead: stragglers randomly caused by TF 2.1 Keras Model saving/loading.
Overheads range from 1% to 300%
Stragglers
