Strategic Projects Report – Q3
Content:
Term Shift, MC-LC Cooperation Customization
towards LCs potential, Financial Model,
Term Shift Mgmt Report
Q32013

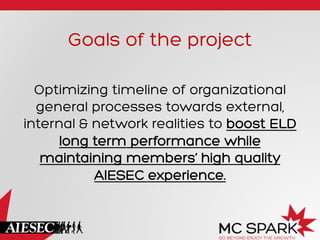

Goals of the project
Optimizing timeline of organizational
general processes towards external,
internal & network realities to boost ELD
long term performance while
maintaining members’ high quality
AIESEC experience.

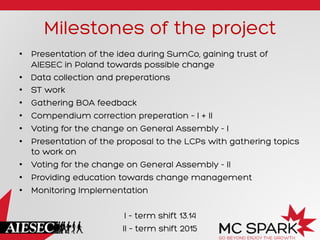

Milestones of the project
•  Presentation of the idea during SumCo, gaining trust of
AIESEC in Poland towards possible change
•  Data collection and preperations
•  ST work
•  Gathering BOA feedback
•  Compendium correction preperation – I + II
•  Voting for the change on General Assembly - I
•  Presentation of the proposal to the LCPs with gathering topics
to work on
•  Voting for the change on General Assembly - II
•  Providing education towards change management
•  Monitoring Implementation
I – term shift 13.14
II – term shift 2015

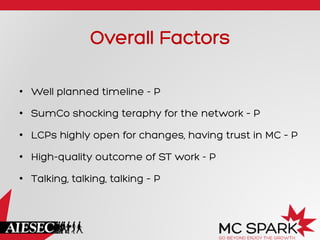

Overall Factors
•  Well planned timeline - P
•  SumCo shocking teraphy for the network – P
•  LCPs highly open for changes, having trust in MC – P
•  High-quality outcome of ST work - P
•  Talking, talking, talking – P

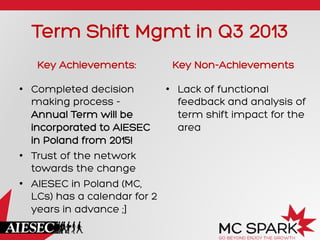

Term Shift Mgmt in Q3 2013
Key Achievements:
•  Completed decision
making process -
Annual Term will be
incorporated to AIESEC
in Poland from 2015!
•  Trust of the network
towards the change
•  AIESEC in Poland (MC,
LCs) has a calendar for 2
years in advance ;]
Key Non-Achievements
•  Lack of functional
feedback and analysis of
term shift impact for the
area
Term Shift Mgmt

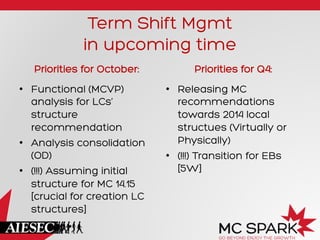

in upcoming time
Priorities for October:
•  Functional (MCVP)
analysis for LCs’
structure
recommendation
•  Analysis consolidation
(OD)
•  (!!!) Assuming initial
structure for MC 14.15
[crucial for creation LC
structures]
Priorities for Q4:
•  Releasing MC
recommendations
towards 2014 local
structues (Virtually or
Physically)
•  (!!!) Transition for EBs
[5W]
MC-LC Cooperation
Customization Report
August 2013

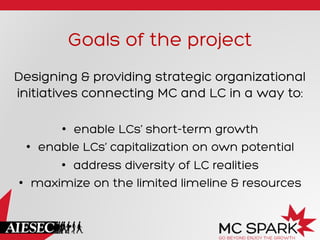

Goals of the project
Designing & providing strategic organizational
initiatives connecting MC and LC in a way to:
•  enable LCs’ short-term growth
•  enable LCs’ capitalization on own potential
•  address diversity of LC realities
•  maximize on the limited limeline & resources

Piliars of the project
Coaching

Na+onal

Conference

Cycle

LC
  Planning

Milestones of the

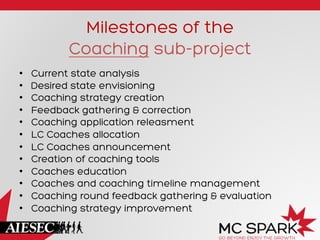

Coaching sub-project
•  Current state analysis
•  Desired state envisioning
•  Coaching strategy creation
•  Feedback gathering & correction
•  Coaching application releasment
•  LC Coaches allocation
•  LC Coaches announcement
•  Creation of coaching tools
•  Coaches education
•  Coaches and coaching timeline management
•  Coaching round feedback gathering & evaluation
•  Coaching strategy improvement

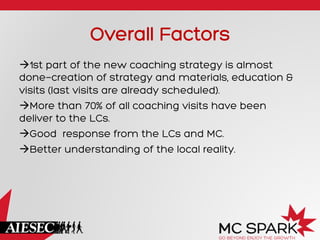

Overall Factors
à1st part of the new coaching strategy is almost
done—creation of strategy and materials, education &
visits (last visits are already scheduled).
àMore than 70% of all coaching visits have been
deliver to the LCs.
àGood response from the LCs and MC.
àBetter understanding of the local reality.

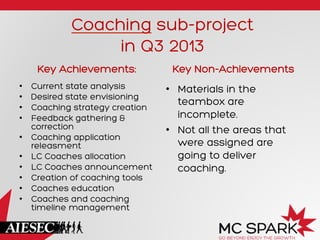

Coaching sub-project
in Q3 2013
Key Achievements:
•  Current state analysis
•  Desired state envisioning
•  Coaching strategy creation
•  Feedback gathering &
correction
•  Coaching application
releasment
•  LC Coaches allocation
•  LC Coaches announcement
•  Creation of coaching tools
•  Coaches education
•  Coaches and coaching
timeline management
Key Non-Achievements
•  Materials in the
teambox are
incomplete.
•  Not all the areas that
were assigned are
going to deliver
coaching.
Coaching sub-project
in upcoming time
Priorities for October:
•  Send coaching
evaluation (part 1)
•  GDC- 1st Monthly skype
meeting.
•  Gathering of all outputs.
Priorities for Q4:
•  General Tracking.

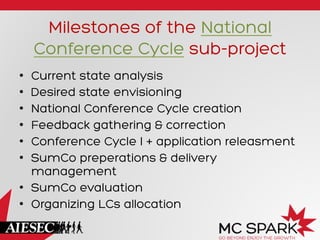

Milestones of the National
Conference Cycle sub-project
•  Current state analysis
•  Desired state envisioning
•  National Conference Cycle creation
•  Feedback gathering & correction
•  Conference Cycle I + application releasment
•  SumCo preperations & delivery
management
•  SumCo evaluation
•  Organizing LCs allocation

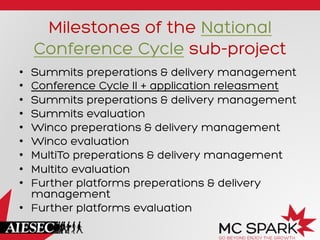

Milestones of the National
Conference Cycle sub-project
•  Summits preperations & delivery management
•  Conference Cycle II + application releasment
•  Summits preperations & delivery management
•  Summits evaluation
•  Winco preperations & delivery management
•  Winco evaluation
•  MultiTo preperations & delivery management
•  Multito evaluation
•  Further platforms preperations & delivery
management
•  Further platforms evaluation

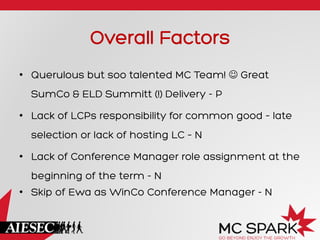

Overall Factors
•  Querulous but soo talented MC Team! J Great
SumCo & ELD Summitt (!) Delivery - P
•  Lack of LCPs responsibility for common good – late
selection or lack of hosting LC – N
•  Lack of Conference Manager role assignment at the
beginning of the term - N
•  Skip of Ewa as WinCo Conference Manager - N

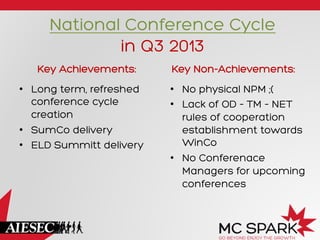

National Conference Cycle
in Q3 2013
Key Achievements:
•  Long term, refreshed
conference cycle
creation
•  SumCo delivery
•  ELD Summitt delivery
Key Non-Achievements:
•  No physical NPM ;(
•  Lack of OD – TM – NET
rules of cooperation
establishment towards
WinCo
•  No Conferenace
Managers for upcoming
conferences

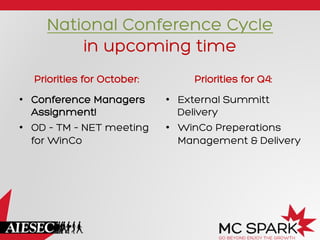

National Conference Cycle
in upcoming time
Priorities for October:
•  Conference Managers
Assignment!
•  OD – TM – NET meeting
for WinCo
Priorities for Q4:
•  External Summitt
Delivery
•  WinCo Preperations
Management & Delivery

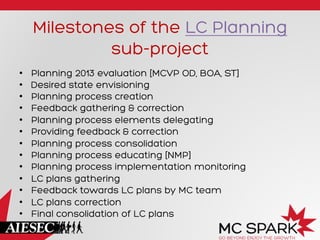

Milestones of the LC Planning
sub-project
•  Planning 2013 evaluation [MCVP OD, BOA, ST]
•  Desired state envisioning
•  Planning process creation
•  Feedback gathering & correction
•  Planning process elements delegating
•  Providing feedback & correction
•  Planning process consolidation
•  Planning process educating [NMP]
•  Planning process implementation monitoring
•  LC plans gathering
•  Feedback towards LC plans by MC team
•  LC plans correction
•  Final consolidation of LC plans

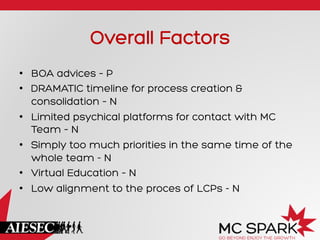

Overall Factors
•  BOA advices – P
•  DRAMATIC timeline for process creation &
consolidation – N
•  Limited psychical platforms for contact with MC
Team – N
•  Simply too much priorities in the same time of the
whole team - N
•  Virtual Education – N
•  Low alignment to the proces of LCPs - N

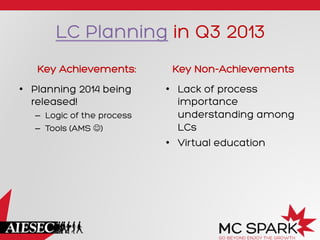

LC Planning in Q3 2013
Key Achievements:
•  Planning 2014 being
released!
–  Logic of the process
–  Tools (AMS J)
Key Non-Achievements
•  Lack of process
importance
understanding among
LCs
•  Virtual education

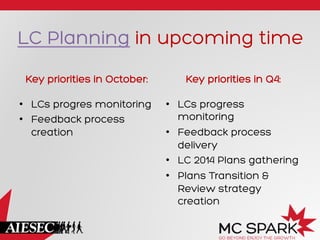

Key priorities in October:
•  LCs progres monitoring
•  Feedback process
creation
Key priorities in Q4:
•  LCs progress
monitoring
•  Feedback process
delivery
•  LC 2014 Plans gathering
•  Plans Transition &
Review strategy
creation
LC Planning in upcoming time
Financial Model Report
Q3 2013

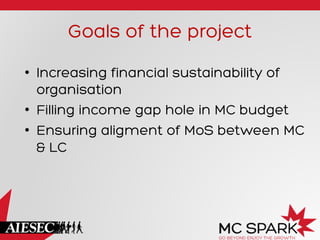

Goals of the project
•  Increasing financial sustainability of
organisation
•  Filling income gap hole in MC budget
•  Ensuring aligment of MoS between MC
& LC

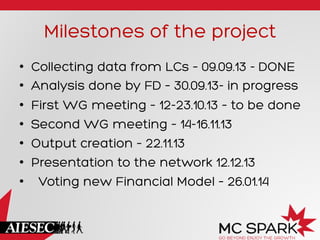

Milestones of the project
•  Collecting data from LCs – 09.09.13 - DONE
•  Analysis done by FD – 30.09.13- in progress
•  First WG meeting – 12-23.10.13 – to be done
•  Second WG meeting – 14-16.11.13
•  Output creation – 22.11.13
•  Presentation to the network 12.12.13
•  Voting new Financial Model – 26.01.14
Overall Factors
•  Other priorities during this Quarter
•  Timeline of the project is more focused
on work in Q4
•  Great support from our BoA !

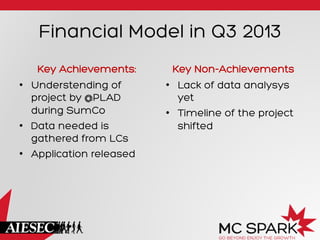

Financial Model in Q3 2013
Key Achievements:
•  Understending of
project by @PLAD
during SumCo
•  Data needed is
gathered from LCs
•  Application released
Key Non-Achievements
•  Lack of data analysys
yet
•  Timeline of the project
shifted

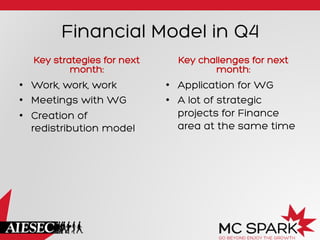

Financial Model in Q4
Key strategies for next
month:
•  Work, work, work
•  Meetings with WG
•  Creation of
redistribution model
Key challenges for next
month:
•  Application for WG
•  A lot of strategic
projects for Finance
area at the same time

Q3 strategic projects report

  • 1.
    Strategic Projects Report– Q3 Content: Term Shift, MC-LC Cooperation Customization towards LCs potential, Financial Model,
  • 2.
    Term Shift MgmtReport Q32013
  • 3.
    Goals of theproject Optimizing timeline of organizational general processes towards external, internal & network realities to boost ELD long term performance while maintaining members’ high quality AIESEC experience.
  • 4.
    Milestones of theproject •  Presentation of the idea during SumCo, gaining trust of AIESEC in Poland towards possible change •  Data collection and preperations •  ST work •  Gathering BOA feedback •  Compendium correction preperation – I + II •  Voting for the change on General Assembly - I •  Presentation of the proposal to the LCPs with gathering topics to work on •  Voting for the change on General Assembly - II •  Providing education towards change management •  Monitoring Implementation I – term shift 13.14 II – term shift 2015
  • 5.
    Overall Factors •  Wellplanned timeline - P •  SumCo shocking teraphy for the network – P •  LCPs highly open for changes, having trust in MC – P •  High-quality outcome of ST work - P •  Talking, talking, talking – P
  • 6.
    Term Shift Mgmtin Q3 2013 Key Achievements: •  Completed decision making process - Annual Term will be incorporated to AIESEC in Poland from 2015! •  Trust of the network towards the change •  AIESEC in Poland (MC, LCs) has a calendar for 2 years in advance ;] Key Non-Achievements •  Lack of functional feedback and analysis of term shift impact for the area
  • 7.
    Term Shift Mgmt inupcoming time Priorities for October: •  Functional (MCVP) analysis for LCs’ structure recommendation •  Analysis consolidation (OD) •  (!!!) Assuming initial structure for MC 14.15 [crucial for creation LC structures] Priorities for Q4: •  Releasing MC recommendations towards 2014 local structues (Virtually or Physically) •  (!!!) Transition for EBs [5W]
  • 8.
  • 9.
    Goals of theproject Designing & providing strategic organizational initiatives connecting MC and LC in a way to: •  enable LCs’ short-term growth •  enable LCs’ capitalization on own potential •  address diversity of LC realities •  maximize on the limited limeline & resources
  • 10.
    Piliars of theproject Coaching   Na+onal   Conference   Cycle   LC  Planning
  • 11.
    Milestones of the Coachingsub-project •  Current state analysis •  Desired state envisioning •  Coaching strategy creation •  Feedback gathering & correction •  Coaching application releasment •  LC Coaches allocation •  LC Coaches announcement •  Creation of coaching tools •  Coaches education •  Coaches and coaching timeline management •  Coaching round feedback gathering & evaluation •  Coaching strategy improvement
  • 12.
    Overall Factors à1st partof the new coaching strategy is almost done—creation of strategy and materials, education & visits (last visits are already scheduled). àMore than 70% of all coaching visits have been deliver to the LCs. àGood response from the LCs and MC. àBetter understanding of the local reality.
  • 13.
    Coaching sub-project in Q32013 Key Achievements: •  Current state analysis •  Desired state envisioning •  Coaching strategy creation •  Feedback gathering & correction •  Coaching application releasment •  LC Coaches allocation •  LC Coaches announcement •  Creation of coaching tools •  Coaches education •  Coaches and coaching timeline management Key Non-Achievements •  Materials in the teambox are incomplete. •  Not all the areas that were assigned are going to deliver coaching.
  • 14.
    Coaching sub-project in upcomingtime Priorities for October: •  Send coaching evaluation (part 1) •  GDC- 1st Monthly skype meeting. •  Gathering of all outputs. Priorities for Q4: •  General Tracking.
  • 15.
    Milestones of theNational Conference Cycle sub-project •  Current state analysis •  Desired state envisioning •  National Conference Cycle creation •  Feedback gathering & correction •  Conference Cycle I + application releasment •  SumCo preperations & delivery management •  SumCo evaluation •  Organizing LCs allocation
  • 16.
    Milestones of theNational Conference Cycle sub-project •  Summits preperations & delivery management •  Conference Cycle II + application releasment •  Summits preperations & delivery management •  Summits evaluation •  Winco preperations & delivery management •  Winco evaluation •  MultiTo preperations & delivery management •  Multito evaluation •  Further platforms preperations & delivery management •  Further platforms evaluation
  • 17.
    Overall Factors •  Querulousbut soo talented MC Team! J Great SumCo & ELD Summitt (!) Delivery - P •  Lack of LCPs responsibility for common good – late selection or lack of hosting LC – N •  Lack of Conference Manager role assignment at the beginning of the term - N •  Skip of Ewa as WinCo Conference Manager - N
  • 18.
    National Conference Cycle inQ3 2013 Key Achievements: •  Long term, refreshed conference cycle creation •  SumCo delivery •  ELD Summitt delivery Key Non-Achievements: •  No physical NPM ;( •  Lack of OD – TM – NET rules of cooperation establishment towards WinCo •  No Conferenace Managers for upcoming conferences
  • 19.
    National Conference Cycle inupcoming time Priorities for October: •  Conference Managers Assignment! •  OD – TM – NET meeting for WinCo Priorities for Q4: •  External Summitt Delivery •  WinCo Preperations Management & Delivery
  • 20.
    Milestones of theLC Planning sub-project •  Planning 2013 evaluation [MCVP OD, BOA, ST] •  Desired state envisioning •  Planning process creation •  Feedback gathering & correction •  Planning process elements delegating •  Providing feedback & correction •  Planning process consolidation •  Planning process educating [NMP] •  Planning process implementation monitoring •  LC plans gathering •  Feedback towards LC plans by MC team •  LC plans correction •  Final consolidation of LC plans
  • 21.
    Overall Factors •  BOAadvices – P •  DRAMATIC timeline for process creation & consolidation – N •  Limited psychical platforms for contact with MC Team – N •  Simply too much priorities in the same time of the whole team - N •  Virtual Education – N •  Low alignment to the proces of LCPs - N
  • 22.
    LC Planning inQ3 2013 Key Achievements: •  Planning 2014 being released! –  Logic of the process –  Tools (AMS J) Key Non-Achievements •  Lack of process importance understanding among LCs •  Virtual education
  • 23.
    Key priorities inOctober: •  LCs progres monitoring •  Feedback process creation Key priorities in Q4: •  LCs progress monitoring •  Feedback process delivery •  LC 2014 Plans gathering •  Plans Transition & Review strategy creation LC Planning in upcoming time
  • 24.
  • 25.
    Goals of theproject •  Increasing financial sustainability of organisation •  Filling income gap hole in MC budget •  Ensuring aligment of MoS between MC & LC
  • 26.
    Milestones of theproject •  Collecting data from LCs – 09.09.13 - DONE •  Analysis done by FD – 30.09.13- in progress •  First WG meeting – 12-23.10.13 – to be done •  Second WG meeting – 14-16.11.13 •  Output creation – 22.11.13 •  Presentation to the network 12.12.13 •  Voting new Financial Model – 26.01.14
  • 27.
    Overall Factors •  Otherpriorities during this Quarter •  Timeline of the project is more focused on work in Q4 •  Great support from our BoA !
  • 28.
    Financial Model inQ3 2013 Key Achievements: •  Understending of project by @PLAD during SumCo •  Data needed is gathered from LCs •  Application released Key Non-Achievements •  Lack of data analysys yet •  Timeline of the project shifted
  • 29.
    Financial Model inQ4 Key strategies for next month: •  Work, work, work •  Meetings with WG •  Creation of redistribution model Key challenges for next month: •  Application for WG •  A lot of strategic projects for Finance area at the same time
