This document is a manual created by the Pan American Health Organization (PAHO) to provide guidance on monitoring project implementation. It explains that monitoring is a management tool to track project progress by comparing actual performance to plans and measuring actual results against expected results. The manual aims to establish standard procedures for project managers to make monitoring more effective and facilitate reporting. It provides a step-by-step explanation of how to develop a monitoring plan and analyze monitoring results to suggest corrective actions. The overall goal is to strengthen project management within PAHO and improve follow up with donors and beneficiaries.
The slides provides an overview on the planning phase of the project plan development. It also provides an introduction on the contents and forms of a project work plan
Learn the 5 Key Project Management Phases that every project manager knows. Perfect information for those professionals curious about how Project Managers plan their projects.
An Introduction to Project Management Krishna Kant
I have tried to present here a brief introduction of project management for the people who wish to get the flavor of project management and what it takes to be a successful project manager.
I have used these slides for the various project management sessions that I have conducted in different forums. And I hope this will help you to understand or re-cap your project management principles.
The slides provides an overview on the planning phase of the project plan development. It also provides an introduction on the contents and forms of a project work plan
Learn the 5 Key Project Management Phases that every project manager knows. Perfect information for those professionals curious about how Project Managers plan their projects.
An Introduction to Project Management Krishna Kant
I have tried to present here a brief introduction of project management for the people who wish to get the flavor of project management and what it takes to be a successful project manager.
I have used these slides for the various project management sessions that I have conducted in different forums. And I hope this will help you to understand or re-cap your project management principles.
LEADERSHIP AND PROJECT MANAGEMENT SKILLS
English language learners: This is a 14-slide presentation prepared by ESL students to help you revisit information about leadership and project management skills, so you can apply these skills in your personal, academic, and professional life. (RZP / December 2018)
Chapter 07 of ICt Project Management based on IOE Engineering syllabus. This chapter covers the knowledge on development of project charters, direct and manage project execution, monitor and control project work and more.Provided by Project Management Sir of KU.
This presentation explains the difference between Monitoring and Evaluation; the types of M&E frameworks; steps in logical framework and its difference from theory of change.
What is a Project and Project Management? This presentation helps you to gain more knowledge about how to manage a project and helps in understanding the Project Life Cycle.
LEADERSHIP AND PROJECT MANAGEMENT SKILLS
English language learners: This is a 14-slide presentation prepared by ESL students to help you revisit information about leadership and project management skills, so you can apply these skills in your personal, academic, and professional life. (RZP / December 2018)
Chapter 07 of ICt Project Management based on IOE Engineering syllabus. This chapter covers the knowledge on development of project charters, direct and manage project execution, monitor and control project work and more.Provided by Project Management Sir of KU.
This presentation explains the difference between Monitoring and Evaluation; the types of M&E frameworks; steps in logical framework and its difference from theory of change.
What is a Project and Project Management? This presentation helps you to gain more knowledge about how to manage a project and helps in understanding the Project Life Cycle.
Comprehensive Multi-year Plan - Universal Immunization Program -
In India Universal Immunization Program - (UIP) is bring forward by the Government, UIP ( Universal Immunization Program) in India is among the most successful vaccination program and cost-effective public health interventions.
Routine Immunization Program in India, Immunization Technical Support, routine immunization services in India, Ministry of Health and Family Welfare, Adverse Event Following Immunization Secretariat, Vaccine logistics and supply chain,Universal Immunization Program in India
This is a report on a mobile application that enables one to easily identify happening places, hotels and guest houses within a particular city, its currently being tested in Gulu City by the the users and the development team
Thèse professionnelle sur les indicateurs de performance RSE et le management...Chris Delepierre
Thèse professionnelle sur les indicateurs de développement durable dans le cadre du Master of Science de gestion de projet à Skema Business School - octobre 2013.
La mesure de la performance durable des projets en entreprise est un thème assez récent que de nombreuses recherches tentent d'approfondir car, après s'être peu à peu installées en entreprise, les stratégies RSE ont désormais besoin de s'armer d'outils et de méthodes rationnels pour légitimer leurs bénéfices et mesurer les progrès accomplis grâce à des données fiables à l'échelle des projets, au niveau opérationnel, et non plus seulement au niveau corporate de la stratégie globale de l'entreprise.
‘Towards Greater Unity and Integration through Shared Values’, then to increase the rate of implementation of regional infrastructure projects and programmes, AU/NEPAD will prioritise projects whose sponsors have strong ‘Shared Value’ credentials and subscribe to the principles of good governance, anti-corruption, and rule of law, etc. Mainstreaming of gender in infrastructure, particularly for the attainment of the MDGs, will be a key objective of the short term AAP 2010–2012. Background, rationale and objectives The AU/NEPAD African Action Plan (AAP) is the defining statement of Africa's current priority programmes and projects related to the promotion of regional and continental integration, anchored in the Guiding Principles of the New Partnership for Africa's Development (NEPAD). The 10th meeting of the Africa Partnership Forum (APF) in Tokyo in 2008 recommended the revision of the AAP. The present report is an Abridged Version of the revised Plan. The African Development Bank, on behalf of the NEPAD Agency, was tasked to carry out a review and revision of the AU/NEPAD African Action Plan (AAP). The revised AU/NEPAD African Action Plan 2010–2015: Advancing Regional and Continental Integration was validated in June 2009 in Tunis, and ...
Skye Residences | Extended Stay Residences Near Toronto Airportmarketingjdass
Experience unparalleled EXTENDED STAY and comfort at Skye Residences located just minutes from Toronto Airport. Discover sophisticated accommodations tailored for discerning travelers.
Website Link :
https://skyeresidences.com/
https://skyeresidences.com/about-us/
https://skyeresidences.com/gallery/
https://skyeresidences.com/rooms/
https://skyeresidences.com/near-by-attractions/
https://skyeresidences.com/commute/
https://skyeresidences.com/contact/
https://skyeresidences.com/queen-suite-with-sofa-bed/
https://skyeresidences.com/queen-suite-with-sofa-bed-and-balcony/
https://skyeresidences.com/queen-suite-with-sofa-bed-accessible/
https://skyeresidences.com/2-bedroom-deluxe-queen-suite-with-sofa-bed/
https://skyeresidences.com/2-bedroom-deluxe-king-queen-suite-with-sofa-bed/
https://skyeresidences.com/2-bedroom-deluxe-queen-suite-with-sofa-bed-accessible/
#Skye Residences Etobicoke, #Skye Residences Near Toronto Airport, #Skye Residences Toronto, #Skye Hotel Toronto, #Skye Hotel Near Toronto Airport, #Hotel Near Toronto Airport, #Near Toronto Airport Accommodation, #Suites Near Toronto Airport, #Etobicoke Suites Near Airport, #Hotel Near Toronto Pearson International Airport, #Toronto Airport Suite Rentals, #Pearson Airport Hotel Suites
Putting the SPARK into Virtual Training.pptxCynthia Clay
This 60-minute webinar, sponsored by Adobe, was delivered for the Training Mag Network. It explored the five elements of SPARK: Storytelling, Purpose, Action, Relationships, and Kudos. Knowing how to tell a well-structured story is key to building long-term memory. Stating a clear purpose that doesn't take away from the discovery learning process is critical. Ensuring that people move from theory to practical application is imperative. Creating strong social learning is the key to commitment and engagement. Validating and affirming participants' comments is the way to create a positive learning environment.
Tata Group Dials Taiwan for Its Chipmaking Ambition in Gujarat’s DholeraAvirahi City Dholera
The Tata Group, a titan of Indian industry, is making waves with its advanced talks with Taiwanese chipmakers Powerchip Semiconductor Manufacturing Corporation (PSMC) and UMC Group. The goal? Establishing a cutting-edge semiconductor fabrication unit (fab) in Dholera, Gujarat. This isn’t just any project; it’s a potential game changer for India’s chipmaking aspirations and a boon for investors seeking promising residential projects in dholera sir.
Visit : https://www.avirahi.com/blog/tata-group-dials-taiwan-for-its-chipmaking-ambition-in-gujarats-dholera/
LA HUG - Video Testimonials with Chynna Morgan - June 2024Lital Barkan
Have you ever heard that user-generated content or video testimonials can take your brand to the next level? We will explore how you can effectively use video testimonials to leverage and boost your sales, content strategy, and increase your CRM data.🤯
We will dig deeper into:
1. How to capture video testimonials that convert from your audience 🎥
2. How to leverage your testimonials to boost your sales 💲
3. How you can capture more CRM data to understand your audience better through video testimonials. 📊
Implicitly or explicitly all competing businesses employ a strategy to select a mix
of marketing resources. Formulating such competitive strategies fundamentally
involves recognizing relationships between elements of the marketing mix (e.g.,
price and product quality), as well as assessing competitive and market conditions
(i.e., industry structure in the language of economics).
VAT Registration Outlined In UAE: Benefits and Requirementsuae taxgpt
Vat Registration is a legal obligation for businesses meeting the threshold requirement, helping companies avoid fines and ramifications. Contact now!
https://viralsocialtrends.com/vat-registration-outlined-in-uae/
Personal Brand Statement:
As an Army veteran dedicated to lifelong learning, I bring a disciplined, strategic mindset to my pursuits. I am constantly expanding my knowledge to innovate and lead effectively. My journey is driven by a commitment to excellence, and to make a meaningful impact in the world.
3.0 Project 2_ Developing My Brand Identity Kit.pptxtanyjahb
A personal brand exploration presentation summarizes an individual's unique qualities and goals, covering strengths, values, passions, and target audience. It helps individuals understand what makes them stand out, their desired image, and how they aim to achieve it.
[Note: This is a partial preview. To download this presentation, visit:
https://www.oeconsulting.com.sg/training-presentations]
Sustainability has become an increasingly critical topic as the world recognizes the need to protect our planet and its resources for future generations. Sustainability means meeting our current needs without compromising the ability of future generations to meet theirs. It involves long-term planning and consideration of the consequences of our actions. The goal is to create strategies that ensure the long-term viability of People, Planet, and Profit.
Leading companies such as Nike, Toyota, and Siemens are prioritizing sustainable innovation in their business models, setting an example for others to follow. In this Sustainability training presentation, you will learn key concepts, principles, and practices of sustainability applicable across industries. This training aims to create awareness and educate employees, senior executives, consultants, and other key stakeholders, including investors, policymakers, and supply chain partners, on the importance and implementation of sustainability.
LEARNING OBJECTIVES
1. Develop a comprehensive understanding of the fundamental principles and concepts that form the foundation of sustainability within corporate environments.
2. Explore the sustainability implementation model, focusing on effective measures and reporting strategies to track and communicate sustainability efforts.
3. Identify and define best practices and critical success factors essential for achieving sustainability goals within organizations.
CONTENTS
1. Introduction and Key Concepts of Sustainability
2. Principles and Practices of Sustainability
3. Measures and Reporting in Sustainability
4. Sustainability Implementation & Best Practices
To download the complete presentation, visit: https://www.oeconsulting.com.sg/training-presentations
Discover the innovative and creative projects that highlight my journey throu...dylandmeas
Discover the innovative and creative projects that highlight my journey through Full Sail University. Below, you’ll find a collection of my work showcasing my skills and expertise in digital marketing, event planning, and media production.
Unveiling the Secrets How Does Generative AI Work.pdfSam H
At its core, generative artificial intelligence relies on the concept of generative models, which serve as engines that churn out entirely new data resembling their training data. It is like a sculptor who has studied so many forms found in nature and then uses this knowledge to create sculptures from his imagination that have never been seen before anywhere else. If taken to cyberspace, gans work almost the same way.
Unveiling the Secrets How Does Generative AI Work.pdf
Monitoring of project implementation
1. Office of External Relations
Pan American Health Organization
Pan American Sanitary Bureau, Regional Office of the
World Health Organization
525 Twenty-third Street, N.W. 20037, U.S.A.
February 1999 P a n A m e r i c a n H e a l t h O r g a n i z a t i o n
o 10 20 30 40 50 60 70 80 90 100
PROJECT IMPLEMENTATION
a manual
MONITORING of
Monitoring Cover Final.qxd 11/3/00 10:42 AM Page 1
2. MONITORING OF PROJECT IMPLEMENTATION
A MANUAL
Office of External Relations
Pan American Health Organization
Pan American Sanitary Bureau, Regional Office of the
World Health Organization
www.paho.org
February 1999
Monitoring of Project Implem.3 11/3/00 10:40 AM Page i

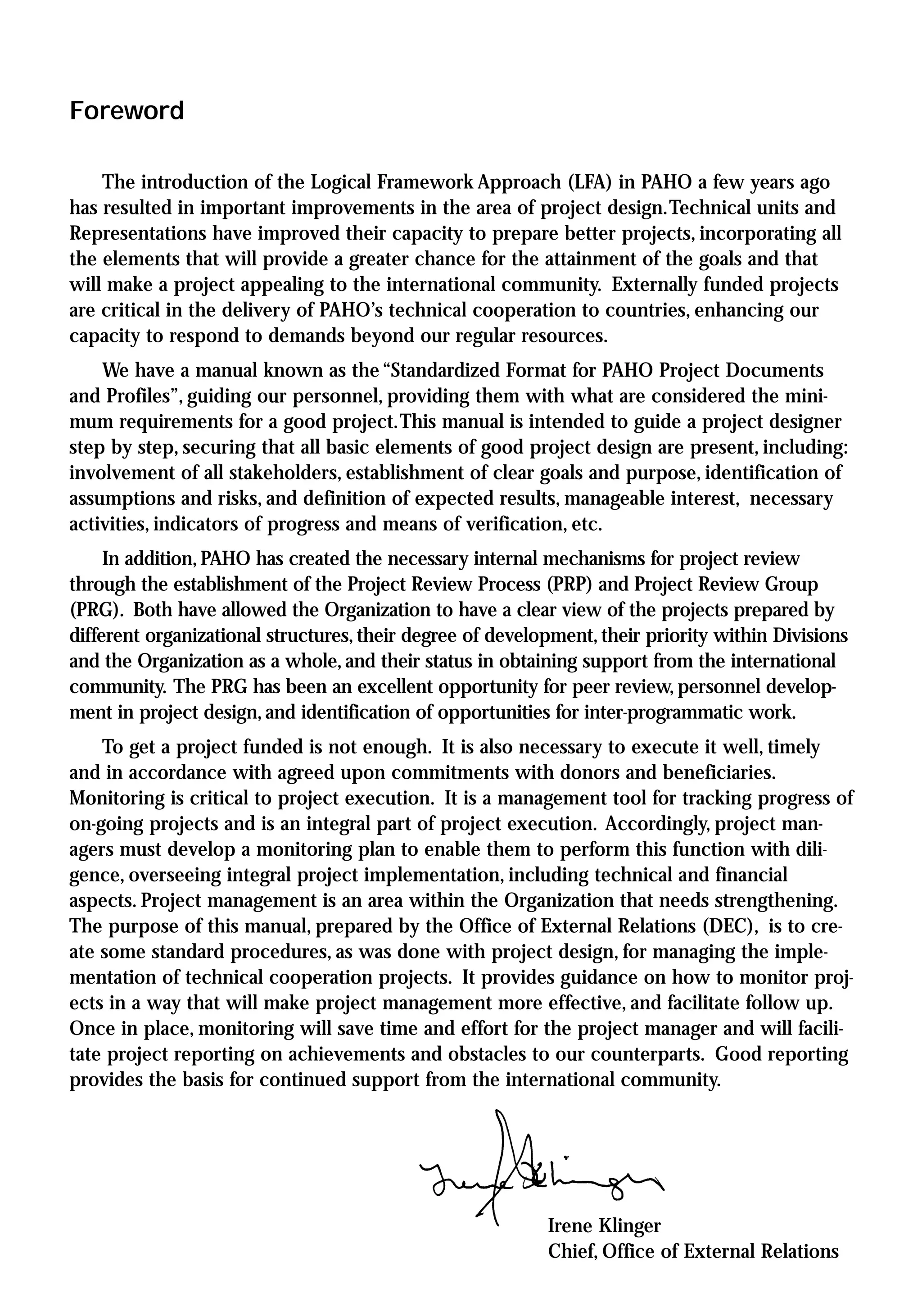

3. Foreword
The introduction of the Logical Framework Approach (LFA) in PAHO a few years ago
has resulted in important improvements in the area of project design.Technical units and
Representations have improved their capacity to prepare better projects, incorporating all
the elements that will provide a greater chance for the attainment of the goals and that
will make a project appealing to the international community. Externally funded projects
are critical in the delivery of PAHO’s technical cooperation to countries, enhancing our
capacity to respond to demands beyond our regular resources.
We have a manual known as the “Standardized Format for PAHO Project Documents
and Profiles”, guiding our personnel, providing them with what are considered the mini-
mum requirements for a good project.This manual is intended to guide a project designer
step by step, securing that all basic elements of good project design are present, including:
involvement of all stakeholders, establishment of clear goals and purpose, identification of
assumptions and risks, and definition of expected results, manageable interest, necessary
activities, indicators of progress and means of verification, etc.
In addition,PAHO has created the necessary internal mechanisms for project review
through the establishment of the Project Review Process (PRP) and Project Review Group
(PRG). Both have allowed the Organization to have a clear view of the projects prepared by
different organizational structures,their degree of development,their priority within Divisions
and the Organization as a whole,and their status in obtaining support from the international
community. The PRG has been an excellent opportunity for peer review,personnel develop-
ment in project design,and identification of opportunities for inter-programmatic work.
To get a project funded is not enough. It is also necessary to execute it well, timely
and in accordance with agreed upon commitments with donors and beneficiaries.
Monitoring is critical to project execution. It is a management tool for tracking progress of
on-going projects and is an integral part of project execution. Accordingly, project man-
agers must develop a monitoring plan to enable them to perform this function with dili-
gence, overseeing integral project implementation, including technical and financial
aspects. Project management is an area within the Organization that needs strengthening.
The purpose of this manual, prepared by the Office of External Relations (DEC), is to cre-
ate some standard procedures, as was done with project design, for managing the imple-
mentation of technical cooperation projects. It provides guidance on how to monitor proj-
ects in a way that will make project management more effective, and facilitate follow up.
Once in place, monitoring will save time and effort for the project manager and will facili-
tate project reporting on achievements and obstacles to our counterparts. Good reporting
provides the basis for continued support from the international community.
Irene Klinger
Chief, Office of External Relations
Monitoring of Project Implem.3 11/3/00 10:40 AM Page ii

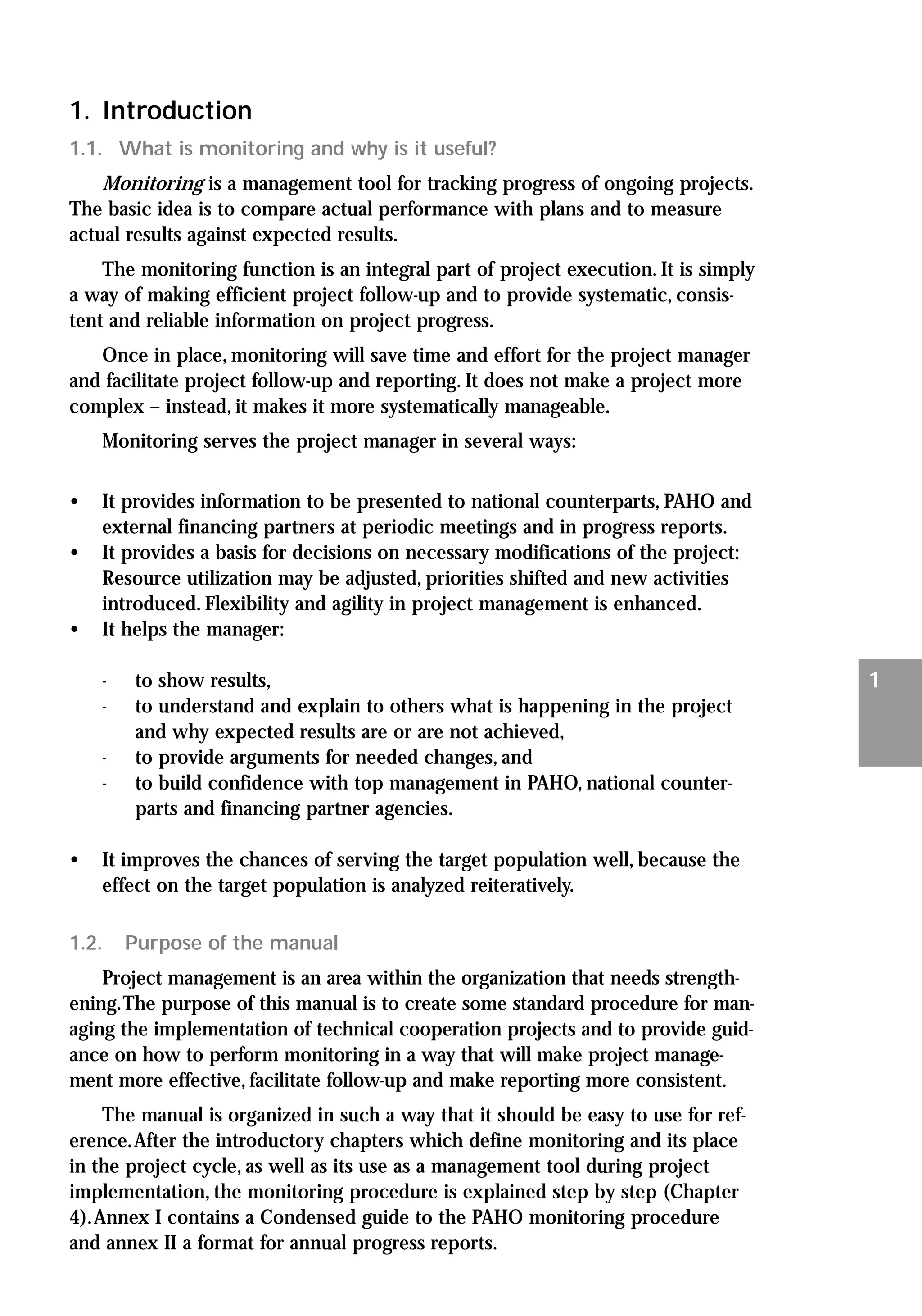

5. 1
1. Introduction
1.1. What is monitoring and why is it useful?
Monitoring is a management tool for tracking progress of ongoing projects.
The basic idea is to compare actual performance with plans and to measure
actual results against expected results.
The monitoring function is an integral part of project execution. It is simply
a way of making efficient project follow-up and to provide systematic, consis-
tent and reliable information on project progress.
Once in place, monitoring will save time and effort for the project manager
and facilitate project follow-up and reporting. It does not make a project more
complex – instead, it makes it more systematically manageable.

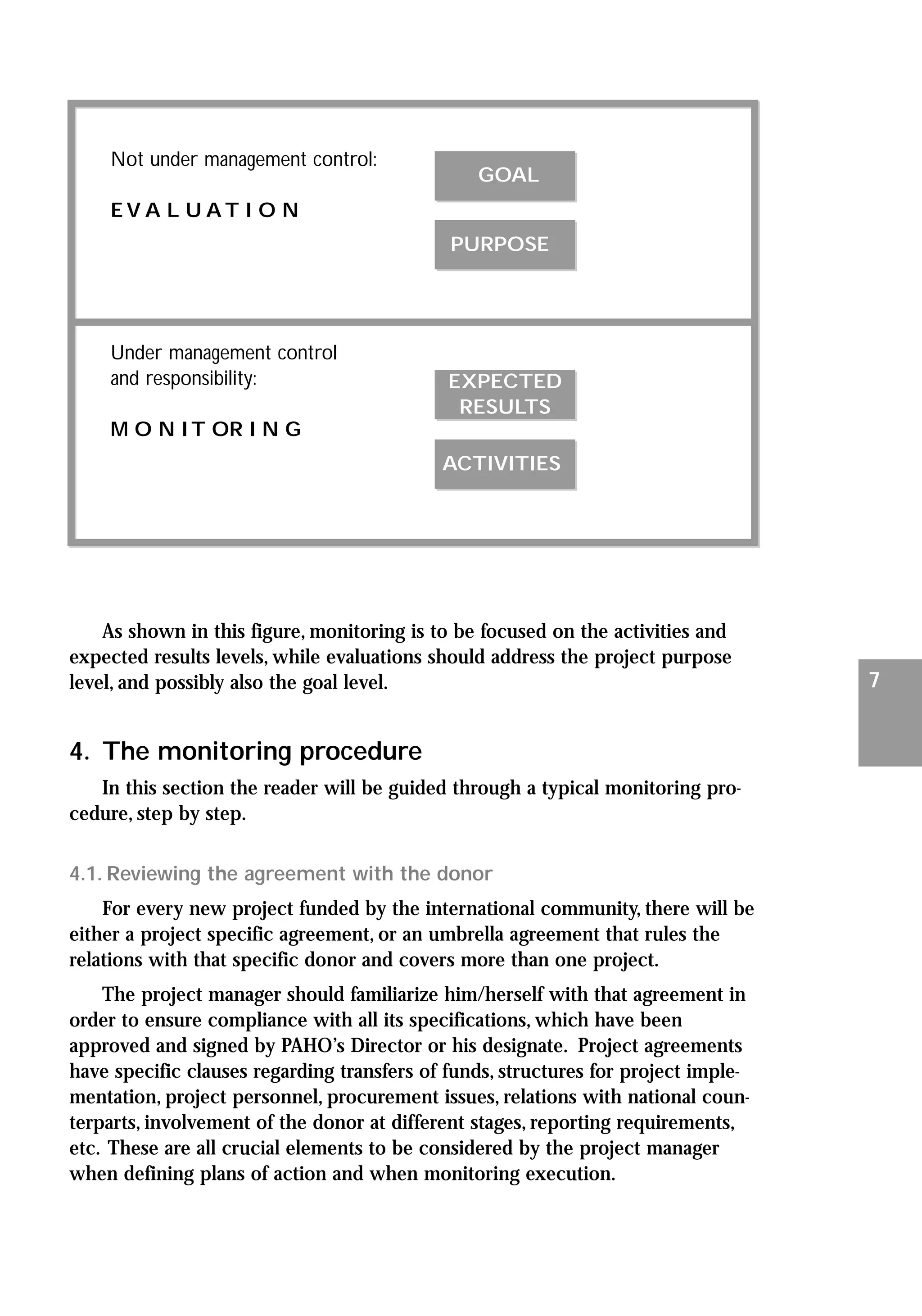

Monitoring serves the project manager in several ways:
• It provides information to be presented to national counterparts, PAHO and
external financing partners at periodic meetings and in progress reports.
• It provides a basis for decisions on necessary modifications of the project:
Resource utilization may be adjusted, priorities shifted and new activities
introduced. Flexibility and agility in project management is enhanced.
• It helps the manager:
- to show results,
- to understand and explain to others what is happening in the project
and why expected results are or are not achieved,
- to provide arguments for needed changes, and
- to build confidence with top management in PAHO, national counter-
parts and financing partner agencies.
• It improves the chances of serving the target population well, because the
effect on the target population is analyzed reiteratively.
1.2. Purpose of the manual
Project management is an area within the organization that needs strength-
ening.The purpose of this manual is to create some standard procedure for man-
aging the implementation of technical cooperation projects and to provide guid-
ance on how to perform monitoring in a way that will make project manage-
ment more effective, facilitate follow-up and make reporting more consistent.

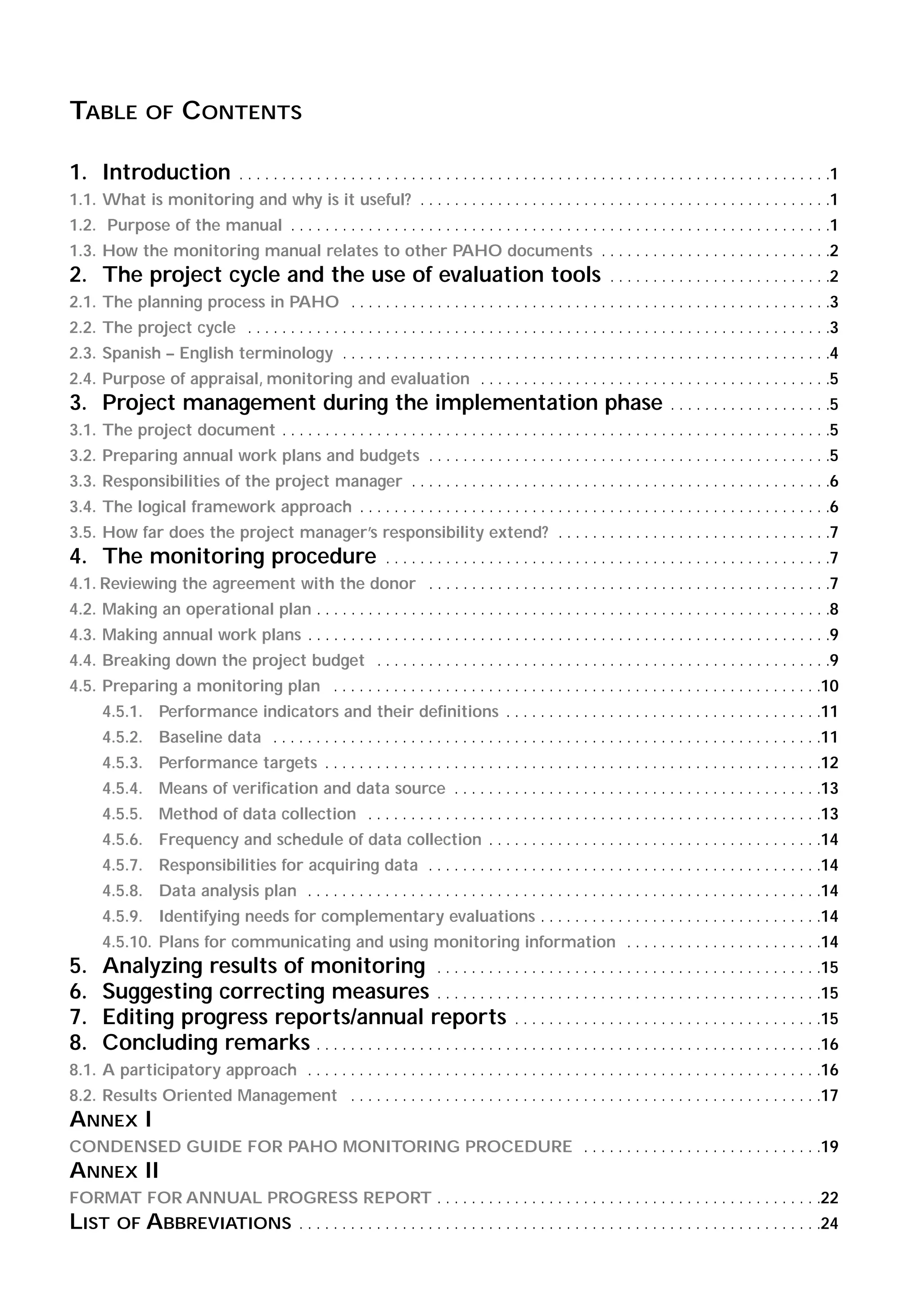

The manual is organized in such a way that it should be easy to use for ref-
erence.After the introductory chapters which define monitoring and its place
in the project cycle, as well as its use as a management tool during project
implementation, the monitoring procedure is explained step by step (Chapter
4).Annex I contains a Condensed guide to the PAHO monitoring procedure
and annex II a format for annual progress reports.
Monitoring of Project Implem.3 11/3/00 10:40 AM Page 1
6. 2

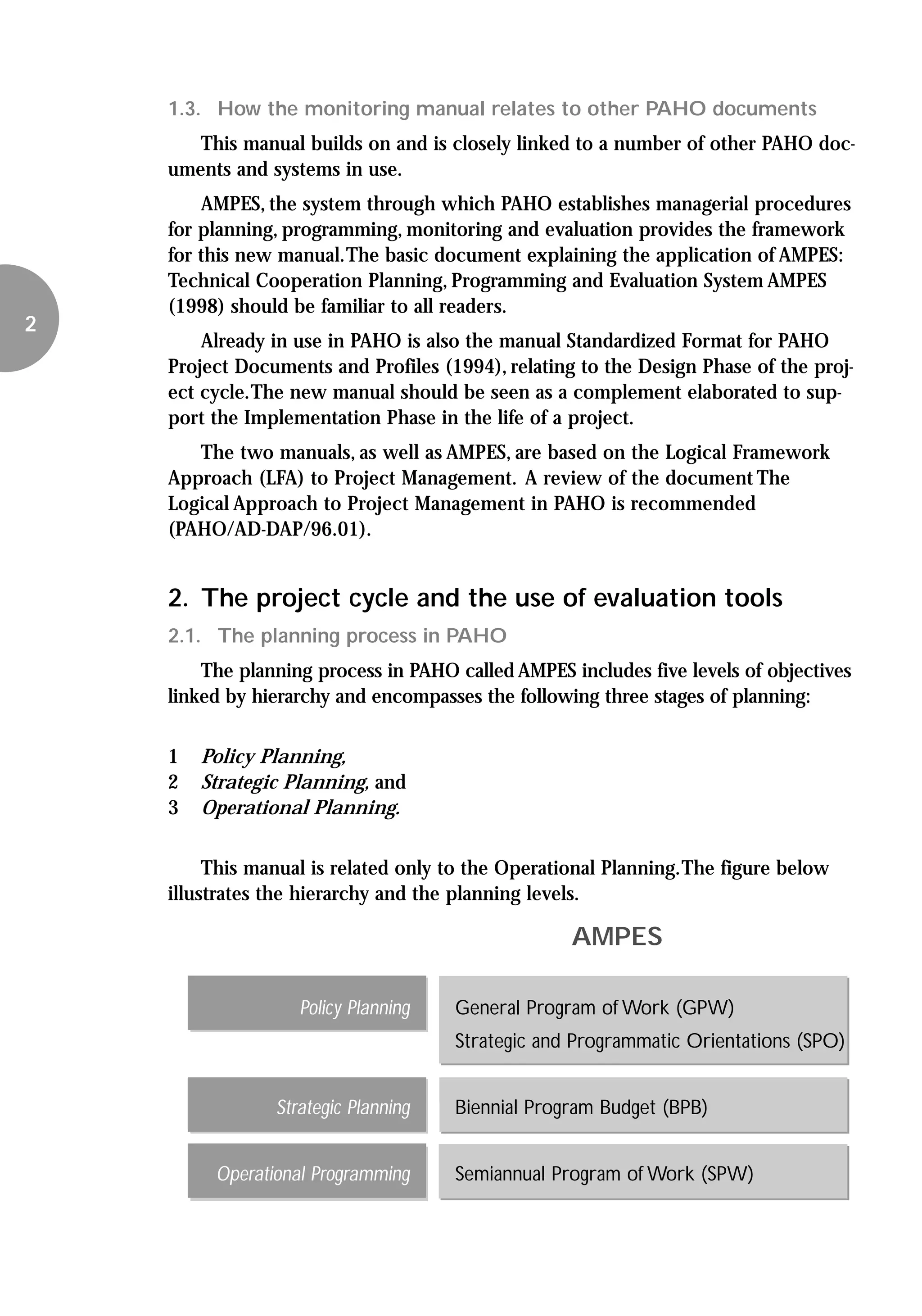

1.3. How the monitoring manual relates to other PAHO documents
This manual builds on and is closely linked to a number of other PAHO doc-
uments and systems in use.
AMPES, the system through which PAHO establishes managerial procedures
for planning, programming, monitoring and evaluation provides the framework
for this new manual.The basic document explaining the application of AMPES:
Technical Cooperation Planning, Programming and Evaluation System AMPES
(1998) should be familiar to all readers.
Already in use in PAHO is also the manual Standardized Format for PAHO
Project Documents and Profiles (1994), relating to the Design Phase of the proj-
ect cycle.The new manual should be seen as a complement elaborated to sup-
port the Implementation Phase in the life of a project.
The two manuals, as well as AMPES, are based on the Logical Framework
Approach (LFA) to Project Management. A review of the document The
Logical Approach to Project Management in PAHO is recommended
(PAHO/AD-DAP/96.01).
2. The project cycle and the use of evaluation tools
2.1. The planning process in PAHO
The planning process in PAHO called AMPES includes five levels of objectives
linked by hierarchy and encompasses the following three stages of planning:
1 Policy Planning,
2 Strategic Planning, and
3 Operational Planning.
This manual is related only to the Operational Planning.The figure below
illustrates the hierarchy and the planning levels.
AMPES
Policy Planning General Program of Work (GPW)
Strategic and Programmatic Orientations (SPO)
Strategic Planning Biennial Program Budget (BPB)
Operational Programming Semiannual Program of Work (SPW)
Monitoring of Project Implem.3 11/3/00 10:40 AM Page 2
7. 3
2.2. The project cycle

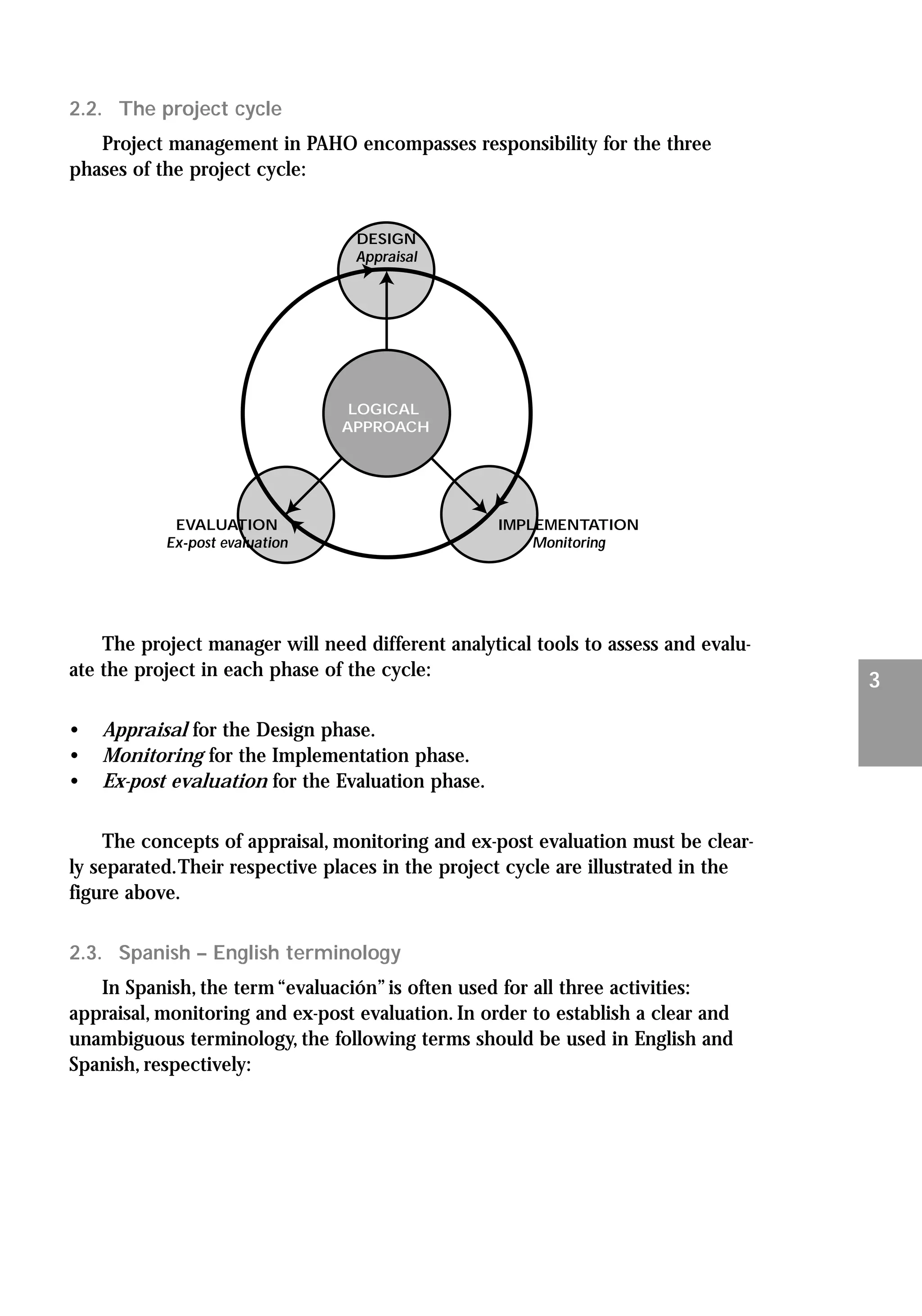

Project management in PAHO encompasses responsibility for the three
phases of the project cycle:
The project manager will need different analytical tools to assess and evalu-
ate the project in each phase of the cycle:
• Appraisal for the Design phase.
• Monitoring for the Implementation phase.
• Ex-post evaluation for the Evaluation phase.
The concepts of appraisal, monitoring and ex-post evaluation must be clear-
ly separated.Their respective places in the project cycle are illustrated in the
figure above.
2.3. Spanish – English terminology
In Spanish, the term “evaluación” is often used for all three activities:
appraisal, monitoring and ex-post evaluation. In order to establish a clear and
unambiguous terminology, the following terms should be used in English and
Spanish, respectively:
LOGICAL
APPROACH
EVALUATION
Ex-post evaluation
DESIGN
Appraisal
IMPLEMENTATION
Monitoring
Monitoring of Project Implem.3 11/3/00 10:40 AM Page 3

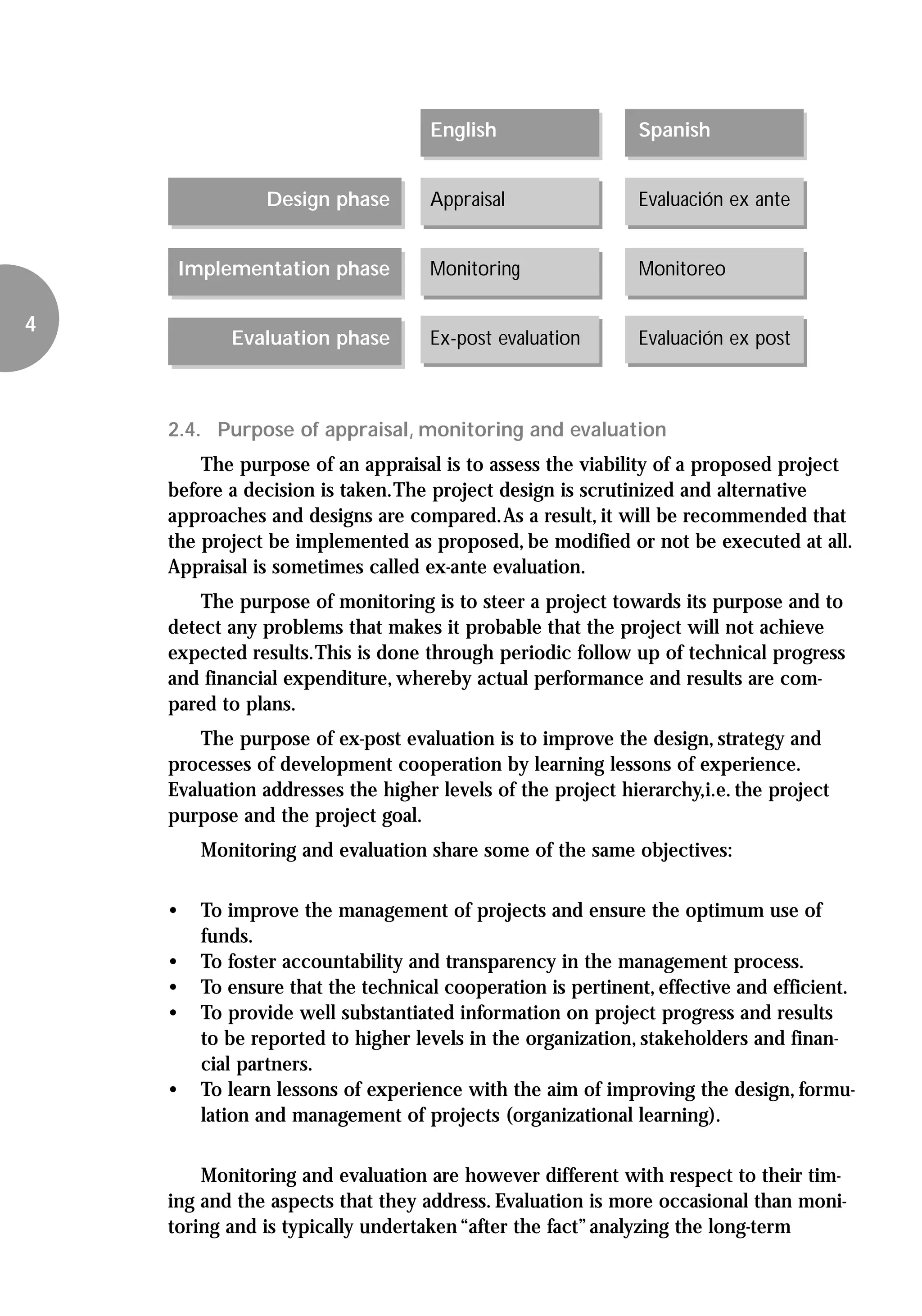

8. 4
2.4. Purpose of appraisal, monitoring and evaluation
The purpose of an appraisal is to assess the viability of a proposed project
before a decision is taken.The project design is scrutinized and alternative
approaches and designs are compared.As a result, it will be recommended that
the project be implemented as proposed, be modified or not be executed at all.
Appraisal is sometimes called ex-ante evaluation.
The purpose of monitoring is to steer a project towards its purpose and to
detect any problems that makes it probable that the project will not achieve
expected results.This is done through periodic follow up of technical progress
and financial expenditure, whereby actual performance and results are com-
pared to plans.
The purpose of ex-post evaluation is to improve the design, strategy and
processes of development cooperation by learning lessons of experience.
Evaluation addresses the higher levels of the project hierarchy,i.e. the project
purpose and the project goal.
Monitoring and evaluation share some of the same objectives:
• To improve the management of projects and ensure the optimum use of
funds.
• To foster accountability and transparency in the management process.
• To ensure that the technical cooperation is pertinent, effective and efficient.
• To provide well substantiated information on project progress and results
to be reported to higher levels in the organization, stakeholders and finan-
cial partners.
• To learn lessons of experience with the aim of improving the design, formu-
lation and management of projects (organizational learning).
Monitoring and evaluation are however different with respect to their tim-
ing and the aspects that they address. Evaluation is more occasional than moni-
toring and is typically undertaken “after the fact” analyzing the long-term
English Spanish
Design phase Appraisal Evaluación ex ante
Implementation phase Monitoring Monitoreo
Evaluation phase Ex-post evaluation Evaluación ex post

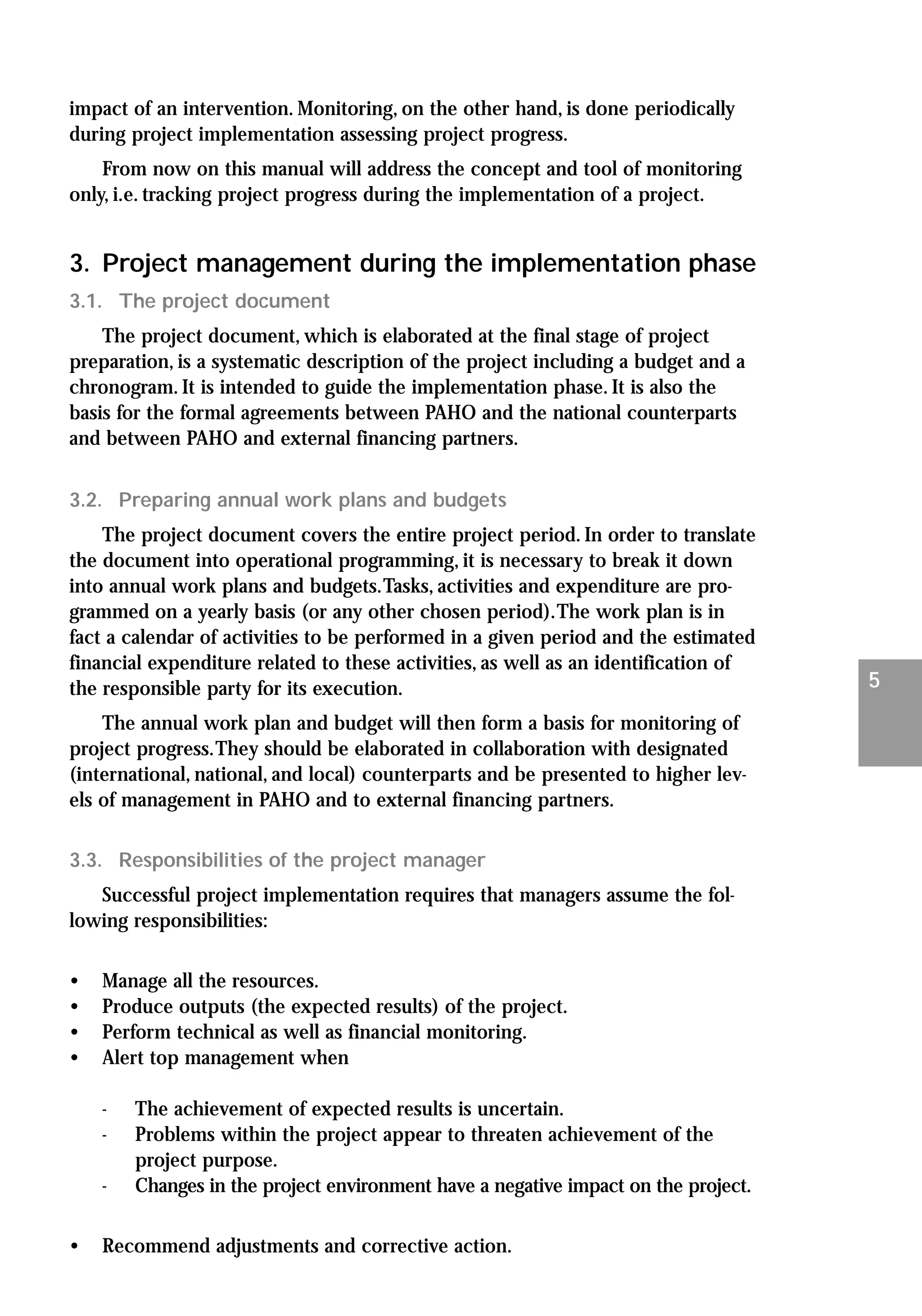

Monitoring of Project Implem.3 11/3/00 10:40 AM Page 4
9. 5
impact of an intervention. Monitoring, on the other hand, is done periodically
during project implementation assessing project progress.
From now on this manual will address the concept and tool of monitoring
only, i.e. tracking project progress during the implementation of a project.
3. Project management during the implementation phase
3.1. The project document
The project document, which is elaborated at the final stage of project
preparation, is a systematic description of the project including a budget and a
chronogram. It is intended to guide the implementation phase. It is also the
basis for the formal agreements between PAHO and the national counterparts
and between PAHO and external financing partners.
3.2. Preparing annual work plans and budgets
The project document covers the entire project period. In order to translate
the document into operational programming, it is necessary to break it down
into annual work plans and budgets.Tasks, activities and expenditure are pro-
grammed on a yearly basis (or any other chosen period).The work plan is in
fact a calendar of activities to be performed in a given period and the estimated
financial expenditure related to these activities, as well as an identification of
the responsible party for its execution.
The annual work plan and budget will then form a basis for monitoring of
project progress.They should be elaborated in collaboration with designated
(international, national, and local) counterparts and be presented to higher lev-
els of management in PAHO and to external financing partners.
3.3. Responsibilities of the project manager
Successful project implementation requires that managers assume the fol-
lowing responsibilities:
• Manage all the resources.
• Produce outputs (the expected results) of the project.
• Perform technical as well as financial monitoring.
• Alert top management when
- The achievement of expected results is uncertain.
- Problems within the project appear to threaten achievement of the
project purpose.
- Changes in the project environment have a negative impact on the project.
• Recommend adjustments and corrective action.
Monitoring of Project Implem.3 11/3/00 10:40 AM Page 5
10. 6

3.4. The logical framework approach
The logical approach (LFA) to project management provides the basic ele-
ments needed for designing complex projects and assisting in their execution,
monitoring and evaluation. LFA is a management tool that facilitates project
management.
It is expected that projects designed with LFA have well-formulated objec-
tives and measurable targets to make it possible to monitor progress and assess
results. Indicators need to be established, means of verification determined and
assumptions explicitly stated.
3.5. How far does the project manager’s responsibility extend?
The LFA matrix also defines the responsibilities for a project.
The lower levels of the LFA hierarchy, up to and including expected results,
are under management control.The project manager will therefore be responsi-
ble and held accountable for achieving the expected results.This is sometimes
called the management contract.
Achievement of the project purpose, on the other hand, depends partly on
factors beyond the project manager’s control; hence he or she cannot assume
responsibility or be held accountable for achieving the project purpose and
even less for attaining the goal. Nevertheless, the project manager is committed
to working towards the purpose and the goal of the project and to alert his/her
superiors, if there is evidence or probability that the project purpose will not
be achieved.
LFA MATRIX FOR PROJECT DESIGN
HIERARCHY OF INDICATORS MEANS OF ASSUMPTIONS
OBJECTIVES VERIFICATION AND RISKS
GOAL
PURPOSE
EXPECTED RESULTS
ACTIVITIES Resources
Monitoring of Project Implem.3 11/3/00 10:40 AM Page 6
11. 7
As shown in this figure, monitoring is to be focused on the activities and
expected results levels, while evaluations should address the project purpose
level, and possibly also the goal level.
4. The monitoring procedure
In this section the reader will be guided through a typical monitoring pro-
cedure, step by step.
4.1. Reviewing the agreement with the donor
For every new project funded by the international community, there will be
either a project specific agreement, or an umbrella agreement that rules the
relations with that specific donor and covers more than one project.
The project manager should familiarize him/herself with that agreement in
order to ensure compliance with all its specifications, which have been
approved and signed by PAHO’s Director or his designate. Project agreements
have specific clauses regarding transfers of funds, structures for project imple-
mentation, project personnel, procurement issues, relations with national coun-
terparts, involvement of the donor at different stages, reporting requirements,
etc. These are all crucial elements to be considered by the project manager
when defining plans of action and when monitoring execution.
Not under management control:
E V A L U A T I O N
Under management control
and responsibility:
M O N I T OR I N G
GOAL
PURPOSE
EXPECTED
RESULTS
ACTIVITIES
Monitoring of Project Implem.3 11/3/00 10:40 AM Page 7
12. 8
4.2. Making an operational plan
Once the project document is approved, an operational plan for the entire project
period must be elaborated. By this is meant that activities necessary for achieving
expected results are outlined indicating the sequence and timing of and defining
dates when stated results are to be achieved.A simplified and condensed operational
plan may be organized as follows:

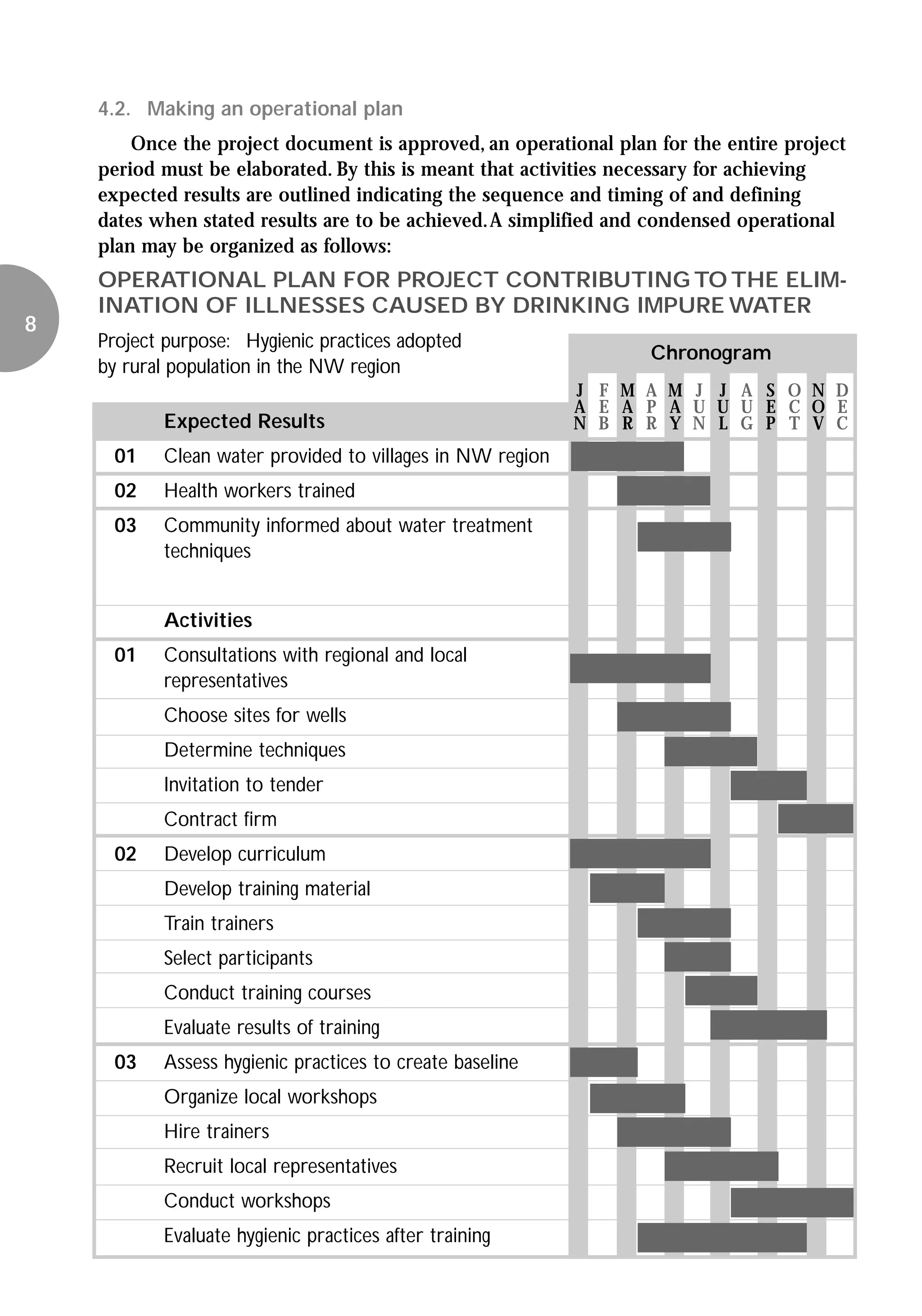

OPERATIONAL PLAN FOR PROJECT CONTRIBUTING TO THE ELIM-
INATION OF ILLNESSES CAUSED BY DRINKING IMPURE WATER
Project purpose: Hygienic practices adopted
by rural population in the NW region
J
A
N
F
E
B
M
A
R
A
P
R
M
A
Y
J
U
N
J
U
L
A
U
G
S
E
P
O
C
T
N
O
V
D
E
CExpected Results
01 Clean water provided to villages in NW region
02 Health workers trained
03 Community informed about water treatment
techniques
Activities
01 Consultations with regional and local
representatives
Choose sites for wells
Determine techniques
Invitation to tender
Contract firm
02 Develop curriculum
Develop training material
Train trainers
Select participants
Conduct training courses
Evaluate results of training
03 Assess hygienic practices to create baseline
Organize local workshops
Hire trainers
Recruit local representatives
Conduct workshops
Evaluate hygienic practices after training
Chronogram
Monitoring of Project Implem.3 11/3/00 10:40 AM Page 8
13. 9

4.3. Making annual work plans
Based on the operational plan annual work plans should be elaborated
specifying in greater detail the timing of technical execution and related finan-
cial expenditure.A calendar of activities and a budget related to planned activi-
ties and expected results should be established. For the first year the plan must
be detailed and specific.Towards the end of the first year a more specific work
plan for the following year will be elaborated and so on.
For a specific year in the work plan the following will be defined:
• expected results to be achieved based on the project document
• activities to be performed
• tasks to be undertaken
• costs,i.e.a budget specifying funds needed to carry out the annual work plan.
The work plan forms the basis for the technical monitoring.
4.4. Breaking down the project budget
The project budget included in the project document indicates the finan-
cial resources needed for the entire project period.The costing of the project is
calculated on the basis of tasks, activities and expected results.This budget now
needs to be broken down by year or shorter periods to show what resources
will be needed to accomplish the work plan.
The annual work plan outlining the technical execution should be accom-
panied by a break down of expected costs related to tasks, activities and the
expected results.
A simplified project budget may look like this:
YEAR 1 YEAR 2 YEAR 3 TOTAL BUDGET
Result 01
Activity 1
Task 1
Task 2
Activity 2
Cost per year
Monitoring of Project Implem.3 11/3/00 10:40 AM Page 9
14. 10

The project manager will need a budget with a considerable level of detail.
Superiors and financing partners, however, will be better served with budgets
where items have been aggregated up to the activities level or even to results
level.This way they get a better overview.
The budget constitutes the basis for the financial monitoring.
4.5. Preparing a monitoring plan
Once the work plan is elaborated, a monitoring plan should be prepared. It
should address the expected results level, i.e. when, whether or to what extent
expected results are being achieved.
At the task and the activity levels, performance will be checked against the
calendar of activities and the budget. No other indicators are needed.This is a
straightforward and relatively uncomplicated exercise and will not be dealt
with further here.
A monitoring plan is used to plan, manage and document the data collec-
tion process. It ensures that comparable data will be collected on a regular and
timely basis. It identifies the indicators to be tracked, specifies the source,
method and schedule of data collection and assigns responsibilities.The plan
will help keeping the monitoring system on track and ensure that data are
reported regularly to project management.
The elaboration of such plan should preferably be undertaken with partici-
pation of all the stakeholders of the project, specially a representative of the
beneficiary party, as well as the financing partner.A multiparty project steering
or technical committee, with representatives of all stakeholders, is usually a
good participatory mechanism to monitor progress. It allows for a shared view
on planning and on monitoring indicators. It also offers opportunity for
exchange of views among all involved on obstacles and potential solutions.
The following elements should be included in the monitoring plan:
Plans for data collection:
• Performance indicators and their definitions
• Baseline data
• Performance targets
• Data Source
• Method of data collection
• Frequency and Schedule of data collection
• Responsibilities for acquiring data
Plans for data analysis, reporting and use of information:
Monitoring of Project Implem.3 11/3/00 10:40 AM Page 10
15. 11
• Data analysis plans
• Identifying needs for complementary evaluation
• Plans for communication and using monitoring information
Each one of these elements is explained below and some advice offered.

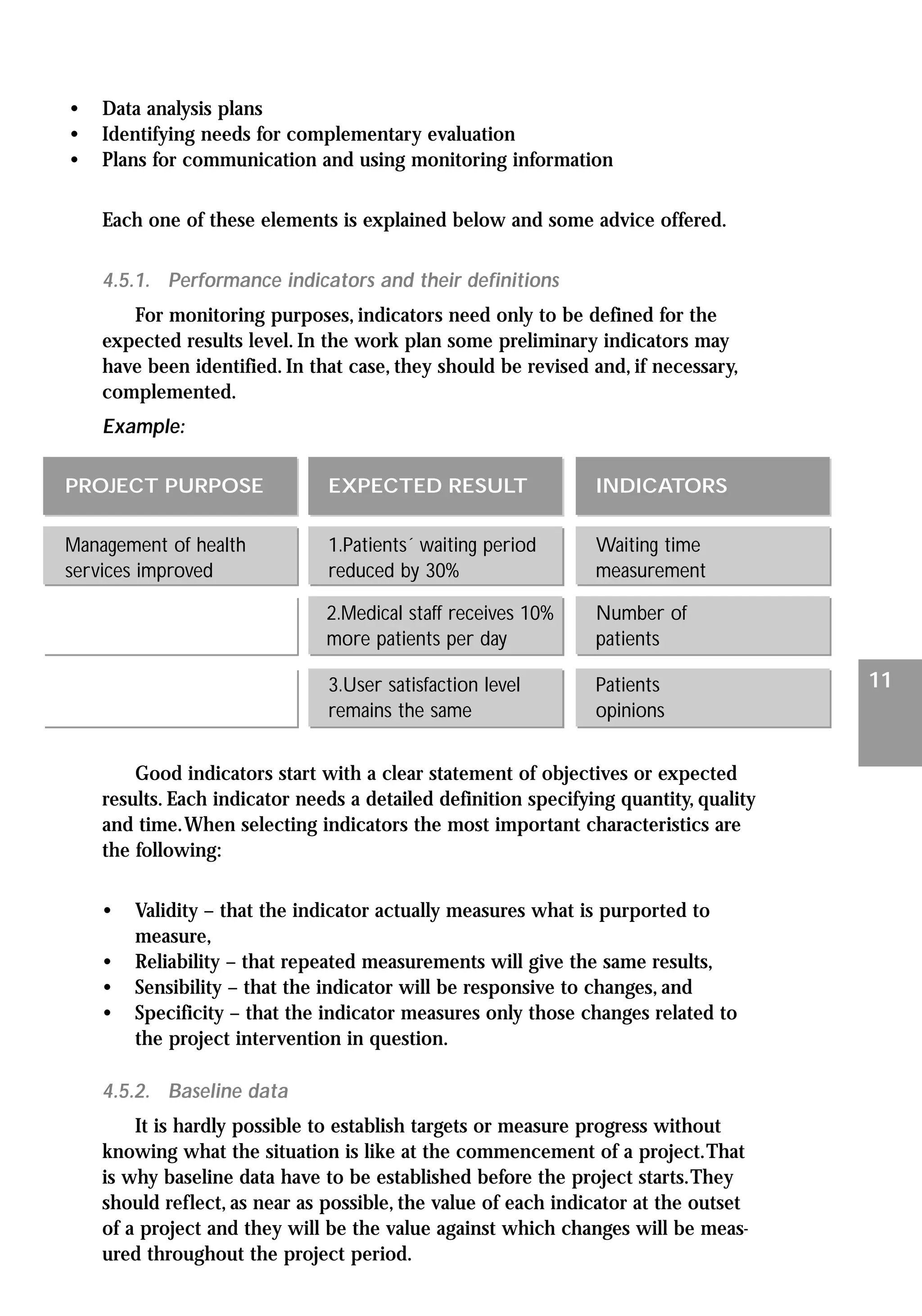

4.5.1. Performance indicators and their definitions
For monitoring purposes, indicators need only to be defined for the
expected results level. In the work plan some preliminary indicators may
have been identified. In that case, they should be revised and, if necessary,
complemented.
Example:
Good indicators start with a clear statement of objectives or expected
results. Each indicator needs a detailed definition specifying quantity, quality
and time.When selecting indicators the most important characteristics are
the following:
• Validity – that the indicator actually measures what is purported to
measure,
• Reliability – that repeated measurements will give the same results,
• Sensibility – that the indicator will be responsive to changes, and
• Specificity – that the indicator measures only those changes related to
the project intervention in question.
4.5.2. Baseline data
It is hardly possible to establish targets or measure progress without
knowing what the situation is like at the commencement of a project.That
is why baseline data have to be established before the project starts.They
should reflect, as near as possible, the value of each indicator at the outset
of a project and they will be the value against which changes will be meas-
ured throughout the project period.
1.Patients´ waiting period
reduced by 30%
Waiting time
measurement
2.Medical staff receives 10%
more patients per day
Number of
patients
3.User satisfaction level
remains the same
Patients
opinions
PROJECT PURPOSE EXPECTED RESULT INDICATORS
Management of health
services improved
Monitoring of Project Implem.3 11/3/00 10:40 AM Page 11
16. 12

Example:
In a project aimed at increased wheat production of small farmers establishing
the baseline is easy, at least in theory:The level of production of wheat at the
outset of a project specifying the quality of wheat.
In cases where expected results are of a more qualitative nature, e.g.“increased
awareness of hygienic practices related to use of water”, it takes a bit more
imagination to establish the baseline.
4.5.3. Performance targets
Targets represent the exact level and timing of expected results to be
achieved by a project.Whereas the indicator defines how performance will
be measured along a scale or dimension, the target identifies the specific
planned level of result to be achieved within an explicit time frame.
Example:
If the expected result is “patients' waiting period reduced by 30% in a two year
period”, interim targets may be set as follows:
“10% reduction of average waiting time by July Year 1; further 10% reduction by
January Year 2 and finally an additional 10% reduction by July Year 2.”
A final target is the planned value of an indicator by the end of the proj-
ect or the planning period. If this time frame is very long, it is advisable to
set interim targets or, as they are often called, milestones.
Example:
Expected result:“Access to clean drinking water to 80% of the rural population
in the province of Santa Clara”.
When the project starts only 50% of the population has access to clean water
(baseline value).The project is planned for a seven-year period.The final target
is 80% to be achieved by the end of 7 years. In this case it may be wise to
establish intermediate targets, e.g. 60% after two years, 70% after four years
and 80% after seven years.
It is a good idea to use a cumulative curve to illustrate the intermediate
targets and the final target.This will be a good basis for comparison with
actual achievements.
Monitoring of Project Implem.3 11/3/00 10:40 AM Page 12
17. 13

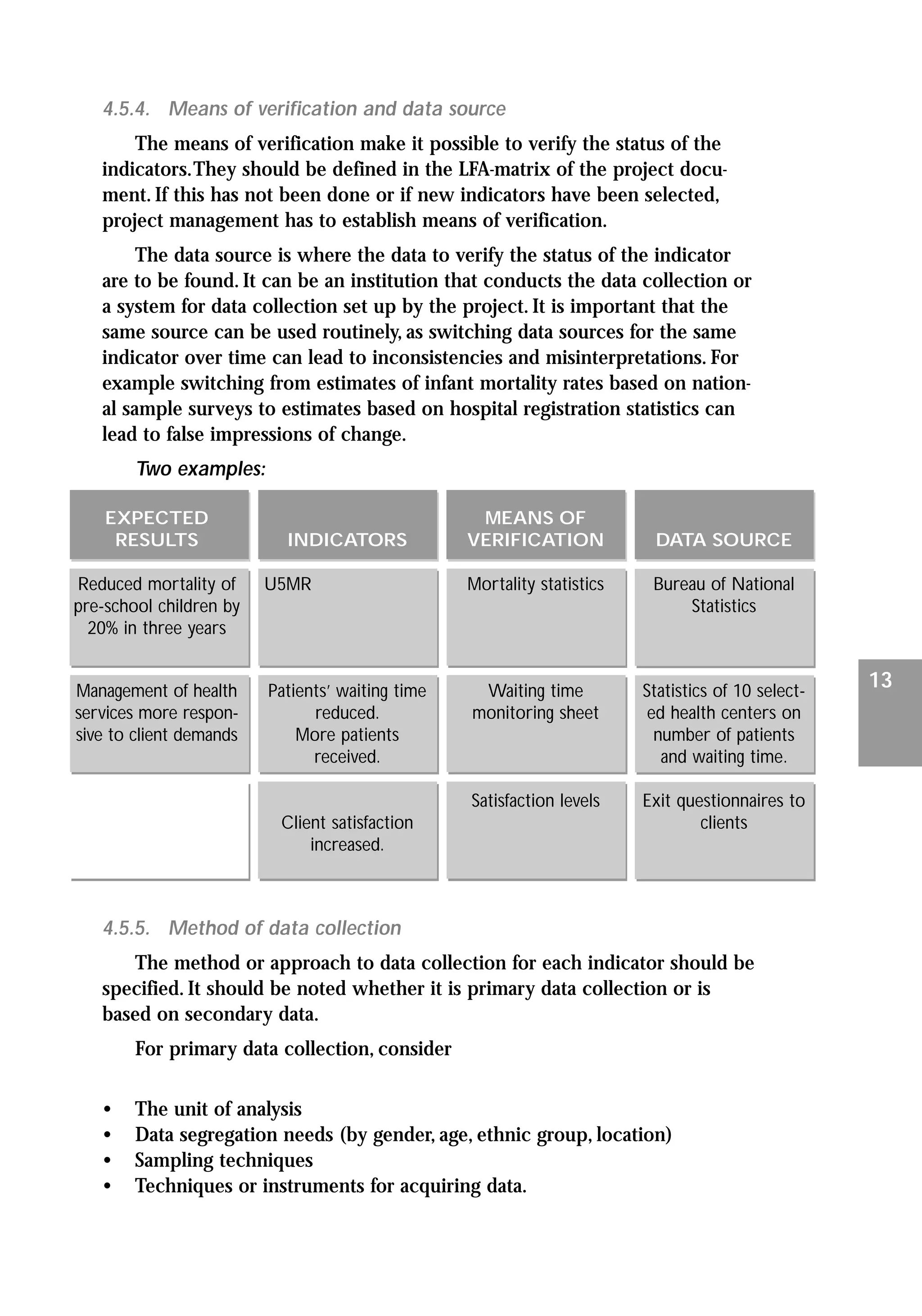

4.5.4. Means of verification and data source
The means of verification make it possible to verify the status of the
indicators.They should be defined in the LFA-matrix of the project docu-
ment. If this has not been done or if new indicators have been selected,
project management has to establish means of verification.
The data source is where the data to verify the status of the indicator
are to be found. It can be an institution that conducts the data collection or
a system for data collection set up by the project. It is important that the
same source can be used routinely, as switching data sources for the same
indicator over time can lead to inconsistencies and misinterpretations. For
example switching from estimates of infant mortality rates based on nation-
al sample surveys to estimates based on hospital registration statistics can
lead to false impressions of change.
Two examples:
4.5.5. Method of data collection
The method or approach to data collection for each indicator should be
specified. It should be noted whether it is primary data collection or is
based on secondary data.
For primary data collection, consider
• The unit of analysis
• Data segregation needs (by gender, age, ethnic group, location)
• Sampling techniques
• Techniques or instruments for acquiring data.
EXPECTED
RESULTS
Reduced mortality of
pre-school children by
20% in three years
Management of health
services more respon-
sive to client demands
INDICATORS
U5MR
Patients’ waiting time
reduced.
More patients
received.
Client satisfaction
increased.
MEANS OF
VERIFICATION
Mortality statistics
Waiting time
monitoring sheet
Satisfaction levels
DATA SOURCE
Bureau of National
Statistics
Statistics of 10 select-
ed health centers on
number of patients
and waiting time.
Exit questionnaires to
clients
Monitoring of Project Implem.3 11/3/00 10:40 AM Page 13
18. 14

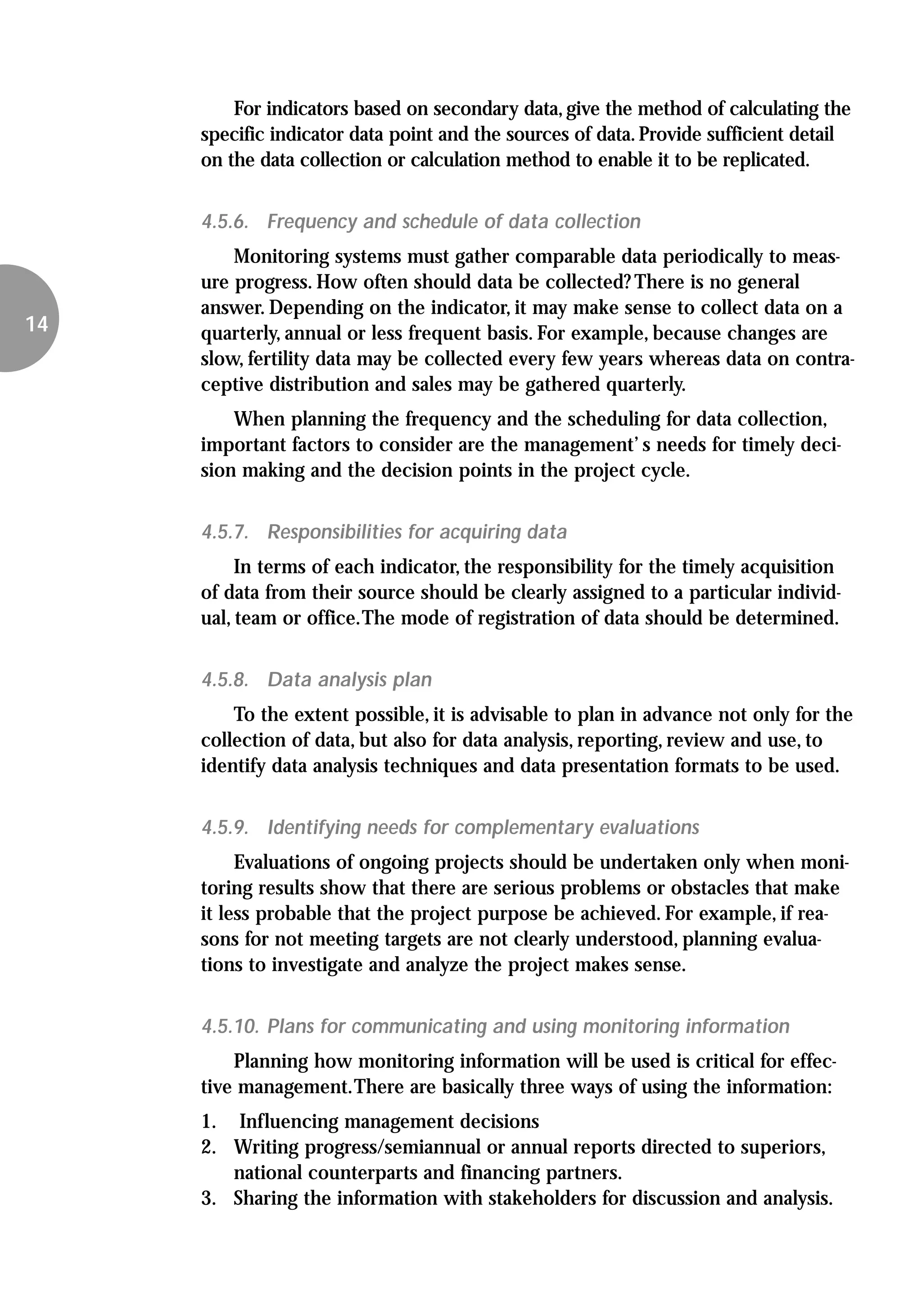

For indicators based on secondary data,give the method of calculating the
specific indicator data point and the sources of data.Provide sufficient detail
on the data collection or calculation method to enable it to be replicated.
4.5.6. Frequency and schedule of data collection
Monitoring systems must gather comparable data periodically to meas-
ure progress. How often should data be collected? There is no general
answer. Depending on the indicator, it may make sense to collect data on a
quarterly, annual or less frequent basis. For example, because changes are
slow, fertility data may be collected every few years whereas data on contra-
ceptive distribution and sales may be gathered quarterly.
When planning the frequency and the scheduling for data collection,
important factors to consider are the management’ s needs for timely deci-
sion making and the decision points in the project cycle.
4.5.7. Responsibilities for acquiring data
In terms of each indicator, the responsibility for the timely acquisition
of data from their source should be clearly assigned to a particular individ-
ual, team or office.The mode of registration of data should be determined.
4.5.8. Data analysis plan
To the extent possible, it is advisable to plan in advance not only for the
collection of data, but also for data analysis, reporting, review and use, to
identify data analysis techniques and data presentation formats to be used.
4.5.9. Identifying needs for complementary evaluations
Evaluations of ongoing projects should be undertaken only when moni-
toring results show that there are serious problems or obstacles that make
it less probable that the project purpose be achieved. For example, if rea-
sons for not meeting targets are not clearly understood, planning evalua-
tions to investigate and analyze the project makes sense.
4.5.10. Plans for communicating and using monitoring information
Planning how monitoring information will be used is critical for effec-
tive management.There are basically three ways of using the information:
1. Influencing management decisions
2. Writing progress/semiannual or annual reports directed to superiors,
national counterparts and financing partners.
3. Sharing the information with stakeholders for discussion and analysis.
Monitoring of Project Implem.3 11/3/00 10:40 AM Page 14
19. 15

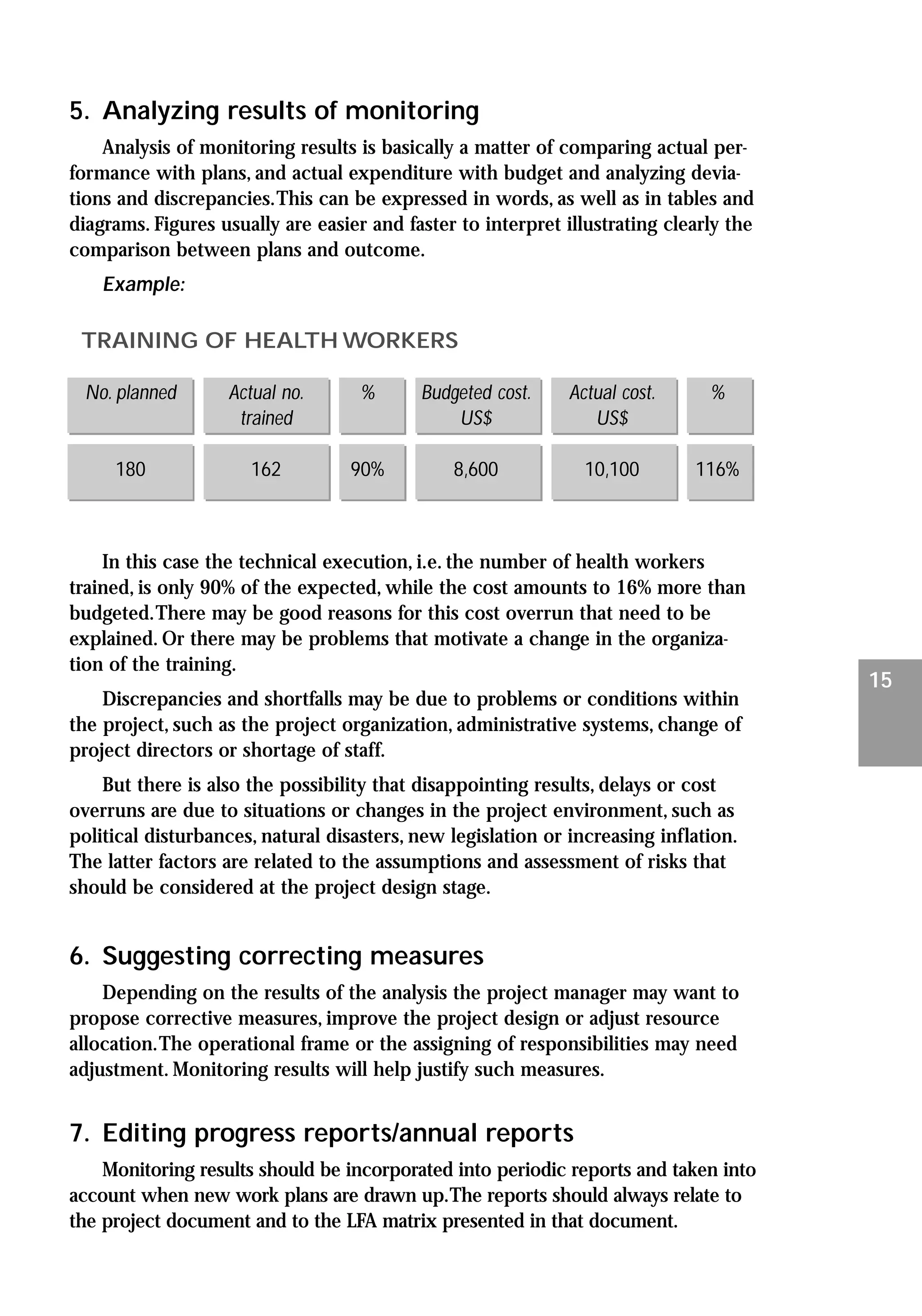

5. Analyzing results of monitoring
Analysis of monitoring results is basically a matter of comparing actual per-
formance with plans, and actual expenditure with budget and analyzing devia-
tions and discrepancies.This can be expressed in words, as well as in tables and
diagrams. Figures usually are easier and faster to interpret illustrating clearly the
comparison between plans and outcome.
Example:
In this case the technical execution, i.e. the number of health workers
trained, is only 90% of the expected, while the cost amounts to 16% more than
budgeted.There may be good reasons for this cost overrun that need to be
explained. Or there may be problems that motivate a change in the organiza-
tion of the training.
Discrepancies and shortfalls may be due to problems or conditions within
the project, such as the project organization, administrative systems, change of
project directors or shortage of staff.
But there is also the possibility that disappointing results, delays or cost
overruns are due to situations or changes in the project environment, such as
political disturbances, natural disasters, new legislation or increasing inflation.
The latter factors are related to the assumptions and assessment of risks that
should be considered at the project design stage.
6. Suggesting correcting measures
Depending on the results of the analysis the project manager may want to
propose corrective measures, improve the project design or adjust resource
allocation.The operational frame or the assigning of responsibilities may need
adjustment. Monitoring results will help justify such measures.
7. Editing progress reports/annual reports
Monitoring results should be incorporated into periodic reports and taken into
account when new work plans are drawn up.The reports should always relate to
the project document and to the LFA matrix presented in that document.
TRAINING OF HEALTH WORKERS
No. planned Actual no. % Budgeted cost. Actual cost. %
trained US$ US$
180 162 90% 8,600 10,100 116%
Monitoring of Project Implem.3 11/3/00 10:40 AM Page 15
20. 16

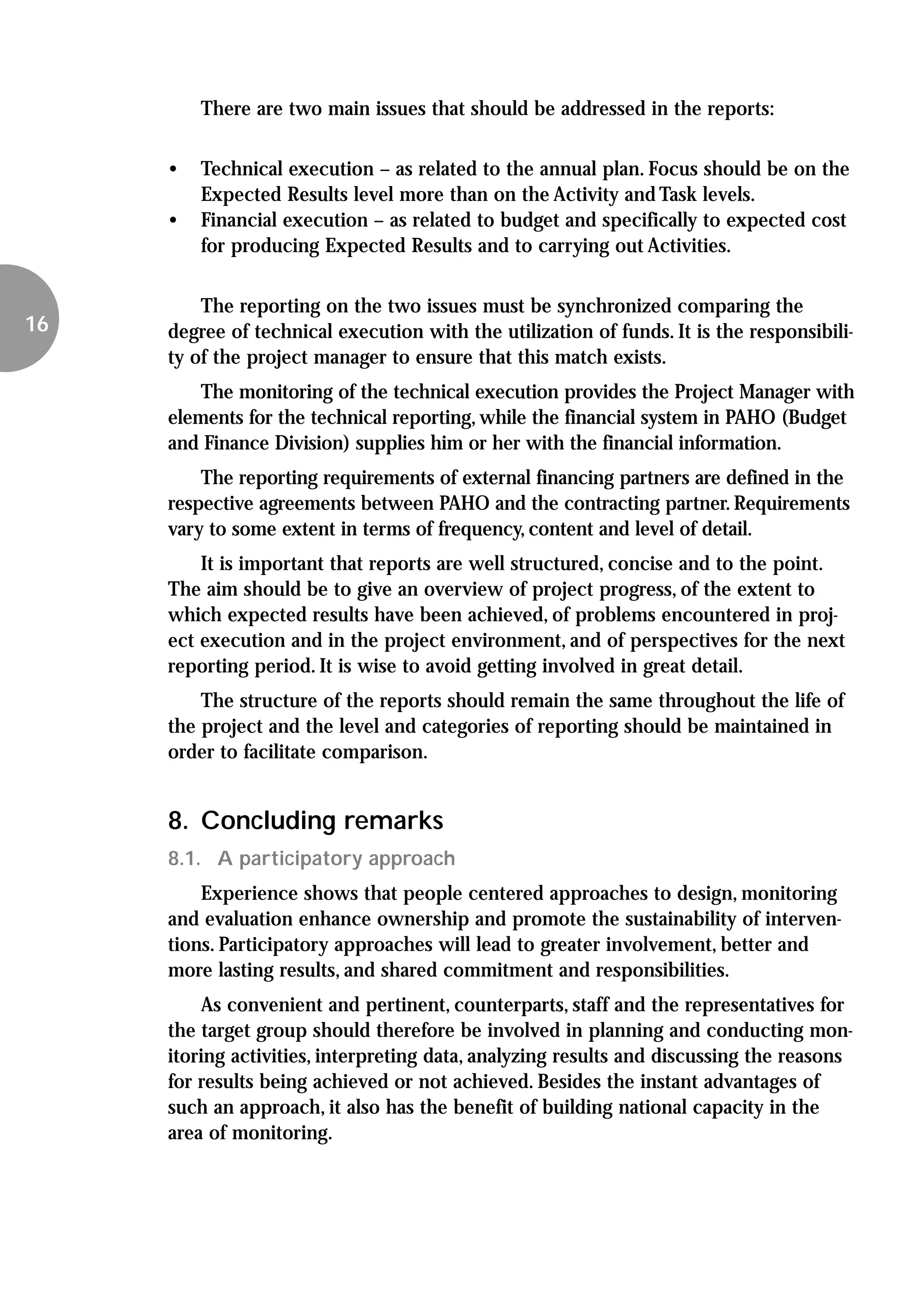

There are two main issues that should be addressed in the reports:
• Technical execution – as related to the annual plan. Focus should be on the
Expected Results level more than on the Activity and Task levels.
• Financial execution – as related to budget and specifically to expected cost
for producing Expected Results and to carrying out Activities.
The reporting on the two issues must be synchronized comparing the
degree of technical execution with the utilization of funds. It is the responsibili-
ty of the project manager to ensure that this match exists.
The monitoring of the technical execution provides the Project Manager with
elements for the technical reporting, while the financial system in PAHO (Budget
and Finance Division) supplies him or her with the financial information.
The reporting requirements of external financing partners are defined in the
respective agreements between PAHO and the contracting partner. Requirements
vary to some extent in terms of frequency, content and level of detail.
It is important that reports are well structured, concise and to the point.
The aim should be to give an overview of project progress, of the extent to
which expected results have been achieved, of problems encountered in proj-
ect execution and in the project environment, and of perspectives for the next
reporting period. It is wise to avoid getting involved in great detail.
The structure of the reports should remain the same throughout the life of
the project and the level and categories of reporting should be maintained in
order to facilitate comparison.
8. Concluding remarks
8.1. A participatory approach
Experience shows that people centered approaches to design, monitoring
and evaluation enhance ownership and promote the sustainability of interven-
tions. Participatory approaches will lead to greater involvement, better and
more lasting results, and shared commitment and responsibilities.
As convenient and pertinent, counterparts, staff and the representatives for
the target group should therefore be involved in planning and conducting mon-
itoring activities, interpreting data, analyzing results and discussing the reasons
for results being achieved or not achieved. Besides the instant advantages of
such an approach, it also has the benefit of building national capacity in the
area of monitoring.
Monitoring of Project Implem.3 11/3/00 10:40 AM Page 16
21. 17

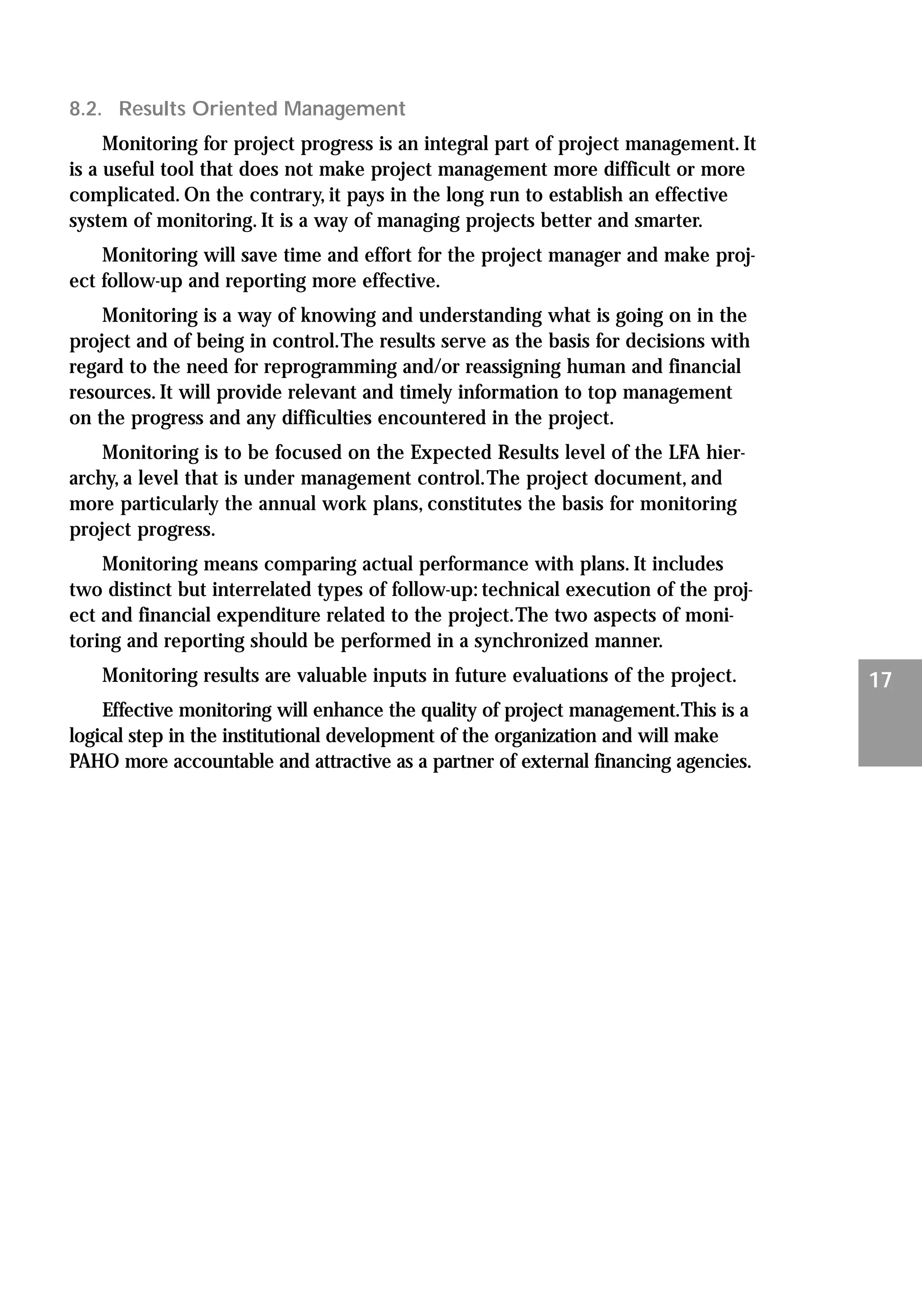

8.2. Results Oriented Management
Monitoring for project progress is an integral part of project management. It
is a useful tool that does not make project management more difficult or more
complicated. On the contrary, it pays in the long run to establish an effective
system of monitoring. It is a way of managing projects better and smarter.
Monitoring will save time and effort for the project manager and make proj-
ect follow-up and reporting more effective.
Monitoring is a way of knowing and understanding what is going on in the
project and of being in control.The results serve as the basis for decisions with
regard to the need for reprogramming and/or reassigning human and financial
resources. It will provide relevant and timely information to top management
on the progress and any difficulties encountered in the project.
Monitoring is to be focused on the Expected Results level of the LFA hier-
archy, a level that is under management control.The project document, and
more particularly the annual work plans, constitutes the basis for monitoring
project progress.
Monitoring means comparing actual performance with plans. It includes
two distinct but interrelated types of follow-up: technical execution of the proj-
ect and financial expenditure related to the project.The two aspects of moni-
toring and reporting should be performed in a synchronized manner.
Monitoring results are valuable inputs in future evaluations of the project.
Effective monitoring will enhance the quality of project management.This is a
logical step in the institutional development of the organization and will make
PAHO more accountable and attractive as a partner of external financing agencies.
Monitoring of Project Implem.3 11/3/00 10:40 AM Page 17
23. 19
Annex I
CONDENSED GUIDE FOR PAHO MONITORING PROCEDURE
1. PREPARING THE MONITORING PLAN
1.1. Review project agreement
Internalize all aspects related to project execution and reporting that
appear in the project agreement signed with the donor.What are the commit-
ments? Which procurement procedures? How often will transfers of funds be
made? Which implementation structure needs to be in place? How often are
reports due? How will donor be involved or not during the life of the project?
1.2. Review LFA matrix for project.
What are the “expected results” to be achieved?
1.3. Review work plan for current year.
What activities are to take place during the year?
What is the expected expenditure (budget) for the year?
What should be achieved by the end of the year?
1.4. Review/develop indicators for tracking progress at the “expected
results” level
Which are the indicators whereby progress can be tracked?
Which targets have been set (expected results level):
• To be achieved by the end of the project?
• To be achieved by the end of the year (intermediate targets or milestones)?
Expected End of project TargetYear 1 ResultYear 1 % of year
results target target
01
02
03
Monitoring of Project Implem.3 11/3/00 10:40 AM Page 19
24. 20

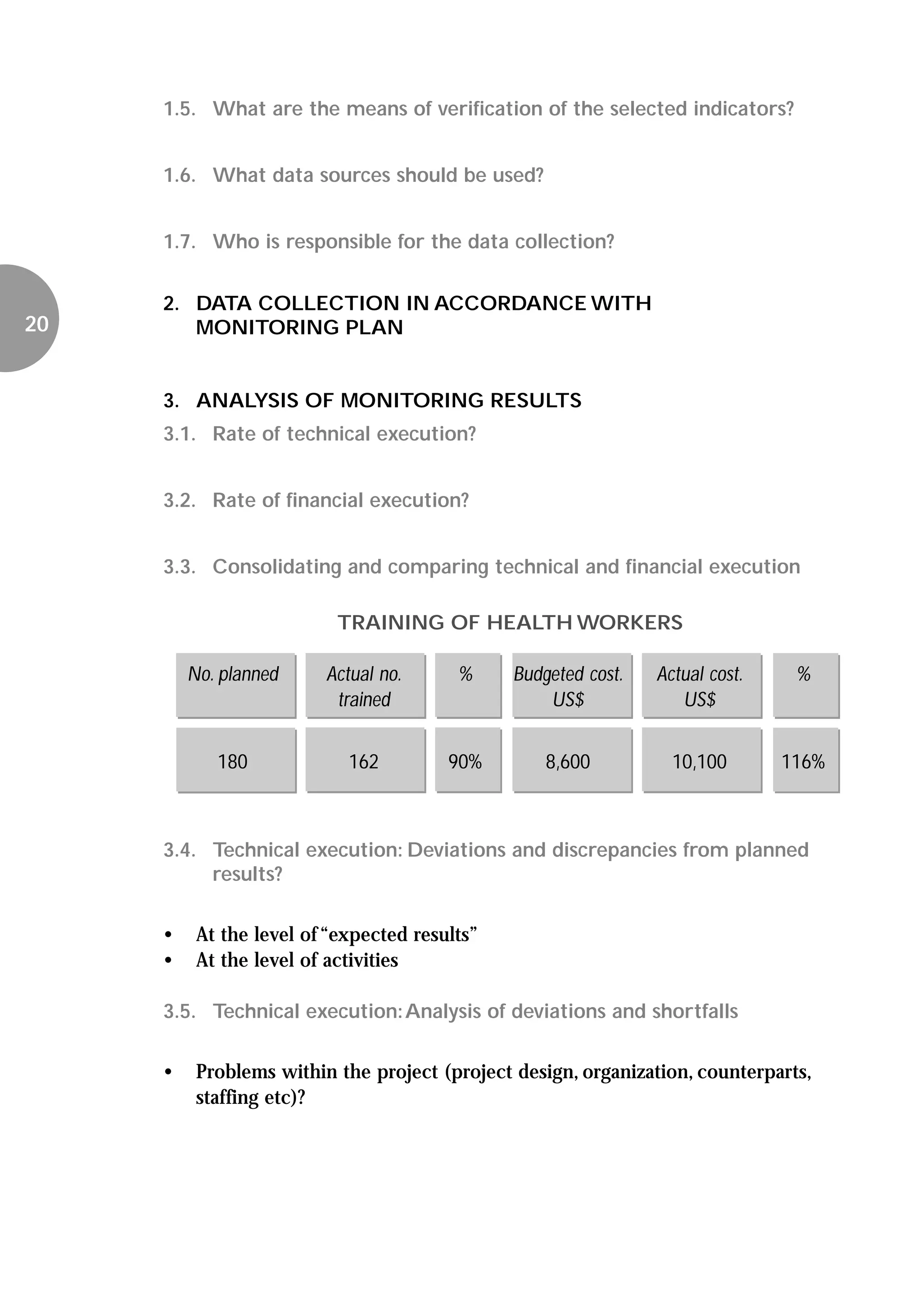

1.5. What are the means of verification of the selected indicators?
1.6. What data sources should be used?
1.7. Who is responsible for the data collection?
2. DATA COLLECTION IN ACCORDANCE WITH
MONITORING PLAN
3. ANALYSIS OF MONITORING RESULTS
3.1. Rate of technical execution?
3.2. Rate of financial execution?
3.3. Consolidating and comparing technical and financial execution
3.4. Technical execution: Deviations and discrepancies from planned
results?
• At the level of “expected results”
• At the level of activities
3.5. Technical execution:Analysis of deviations and shortfalls
• Problems within the project (project design, organization, counterparts,
staffing etc)?
TRAINING OF HEALTH WORKERS
No. planned Actual no. % Budgeted cost. Actual cost. %
trained US$ US$
180 162 90% 8,600 10,100 116%
Monitoring of Project Implem.3 11/3/00 10:40 AM Page 20
25. 21

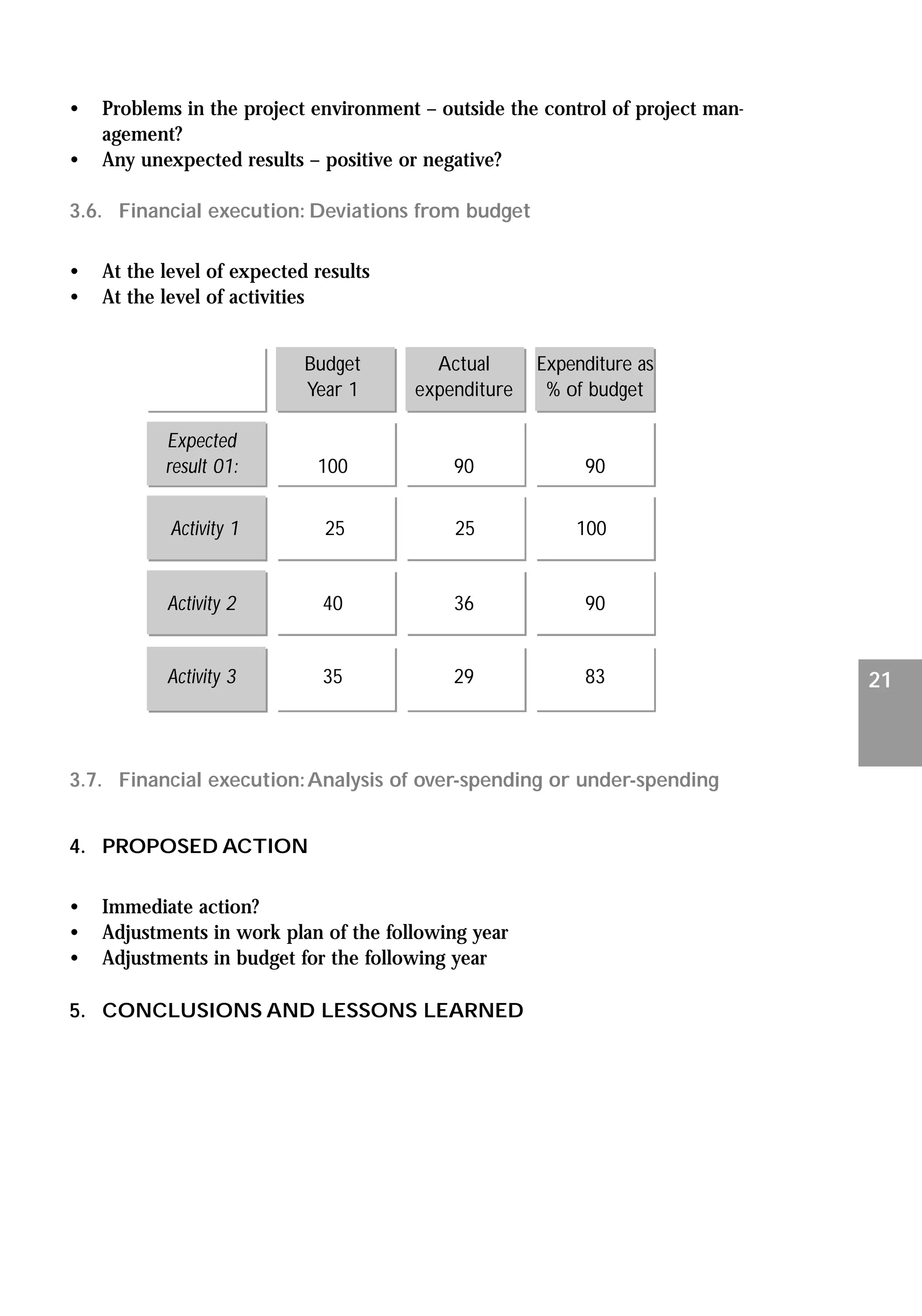

• Problems in the project environment – outside the control of project man-
agement?
• Any unexpected results – positive or negative?
3.6. Financial execution: Deviations from budget
• At the level of expected results
• At the level of activities
3.7. Financial execution:Analysis of over-spending or under-spending
4. PROPOSED ACTION
• Immediate action?
• Adjustments in work plan of the following year
• Adjustments in budget for the following year
5. CONCLUSIONS AND LESSONS LEARNED
Budget Actual Expenditure as
Year 1 expenditure % of budget
Expected
result 01: 100 90 90
Activity 1 25 25 100
Activity 2 40 36 90
Activity 3 35 29 83
Monitoring of Project Implem.3 11/3/00 10:40 AM Page 21
26. 22
ANNEX II

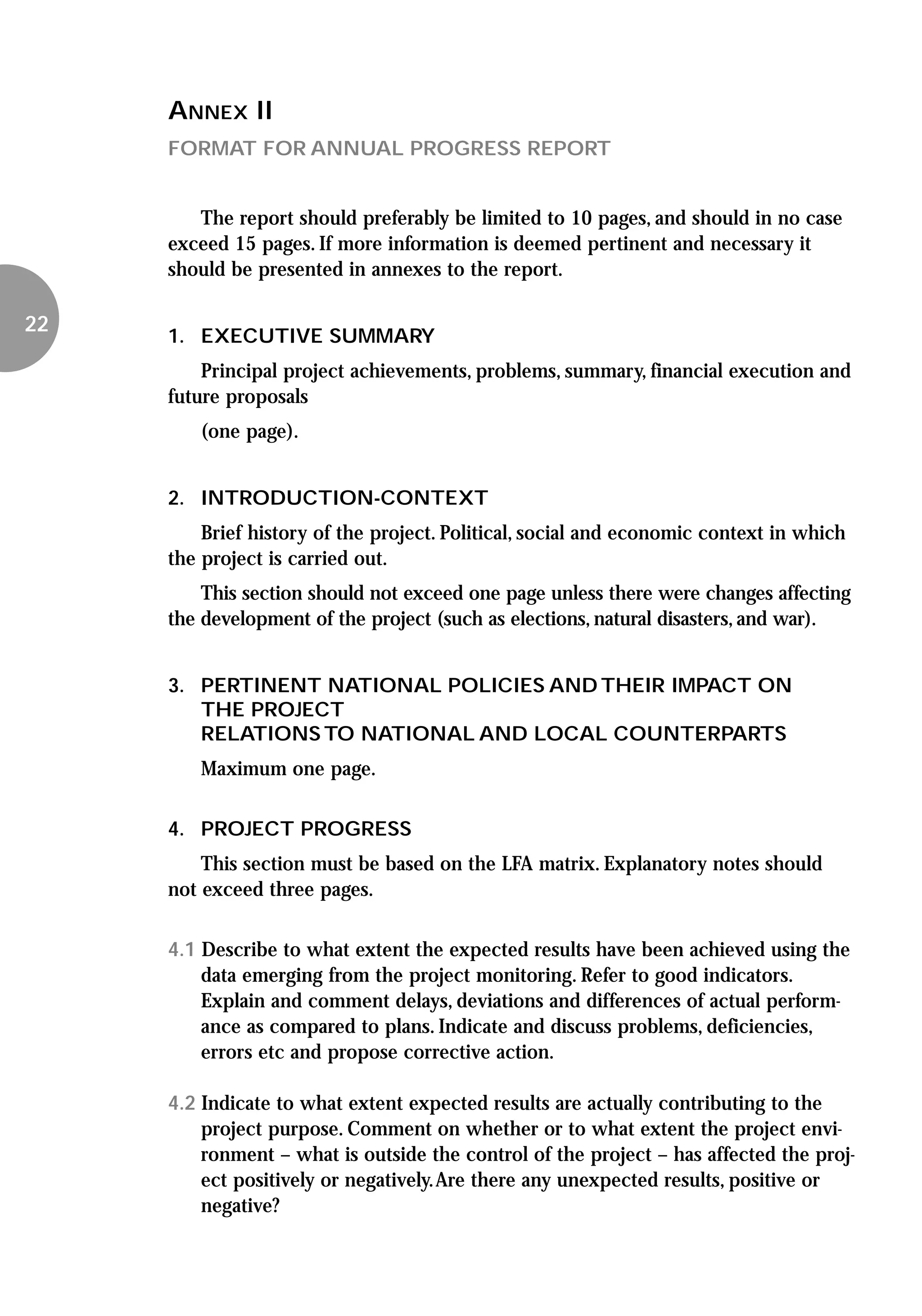

FORMAT FOR ANNUAL PROGRESS REPORT
The report should preferably be limited to 10 pages, and should in no case
exceed 15 pages. If more information is deemed pertinent and necessary it
should be presented in annexes to the report.
1. EXECUTIVE SUMMARY
Principal project achievements, problems, summary, financial execution and
future proposals
(one page).
2. INTRODUCTION-CONTEXT
Brief history of the project. Political, social and economic context in which
the project is carried out.
This section should not exceed one page unless there were changes affecting
the development of the project (such as elections, natural disasters, and war).
3. PERTINENT NATIONAL POLICIES AND THEIR IMPACT ON
THE PROJECT
RELATIONS TO NATIONAL AND LOCAL COUNTERPARTS
Maximum one page.
4. PROJECT PROGRESS
This section must be based on the LFA matrix. Explanatory notes should
not exceed three pages.
4.1 Describe to what extent the expected results have been achieved using the
data emerging from the project monitoring. Refer to good indicators.
Explain and comment delays, deviations and differences of actual perform-
ance as compared to plans. Indicate and discuss problems, deficiencies,
errors etc and propose corrective action.
4.2 Indicate to what extent expected results are actually contributing to the
project purpose. Comment on whether or to what extent the project envi-
ronment – what is outside the control of the project – has affected the proj-
ect positively or negatively.Are there any unexpected results, positive or
negative?
Monitoring of Project Implem.3 11/3/00 10:40 AM Page 22
27. 23

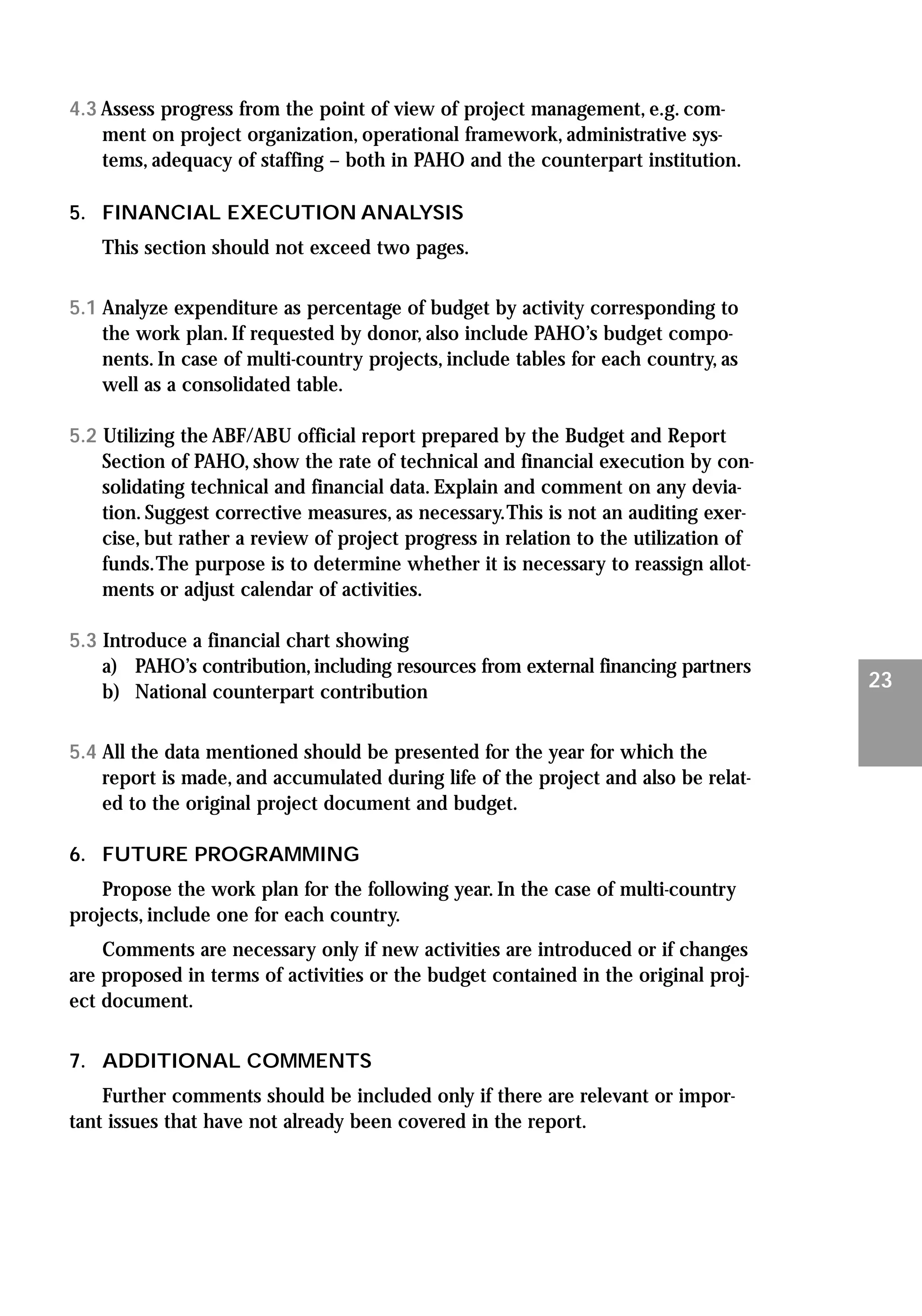

4.3 Assess progress from the point of view of project management, e.g. com-
ment on project organization, operational framework, administrative sys-
tems, adequacy of staffing – both in PAHO and the counterpart institution.
5. FINANCIAL EXECUTION ANALYSIS
This section should not exceed two pages.
5.1 Analyze expenditure as percentage of budget by activity corresponding to
the work plan. If requested by donor, also include PAHO’s budget compo-
nents. In case of multi-country projects, include tables for each country, as
well as a consolidated table.
5.2 Utilizing the ABF/ABU official report prepared by the Budget and Report
Section of PAHO, show the rate of technical and financial execution by con-
solidating technical and financial data. Explain and comment on any devia-
tion. Suggest corrective measures, as necessary.This is not an auditing exer-
cise, but rather a review of project progress in relation to the utilization of
funds.The purpose is to determine whether it is necessary to reassign allot-
ments or adjust calendar of activities.
5.3 Introduce a financial chart showing
a) PAHO’s contribution,including resources from external financing partners
b) National counterpart contribution
5.4 All the data mentioned should be presented for the year for which the
report is made, and accumulated during life of the project and also be relat-
ed to the original project document and budget.
6. FUTURE PROGRAMMING
Propose the work plan for the following year. In the case of multi-country
projects, include one for each country.
Comments are necessary only if new activities are introduced or if changes
are proposed in terms of activities or the budget contained in the original proj-
ect document.
7. ADDITIONAL COMMENTS
Further comments should be included only if there are relevant or impor-
tant issues that have not already been covered in the report.
Monitoring of Project Implem.3 11/3/00 10:40 AM Page 23
28. 24

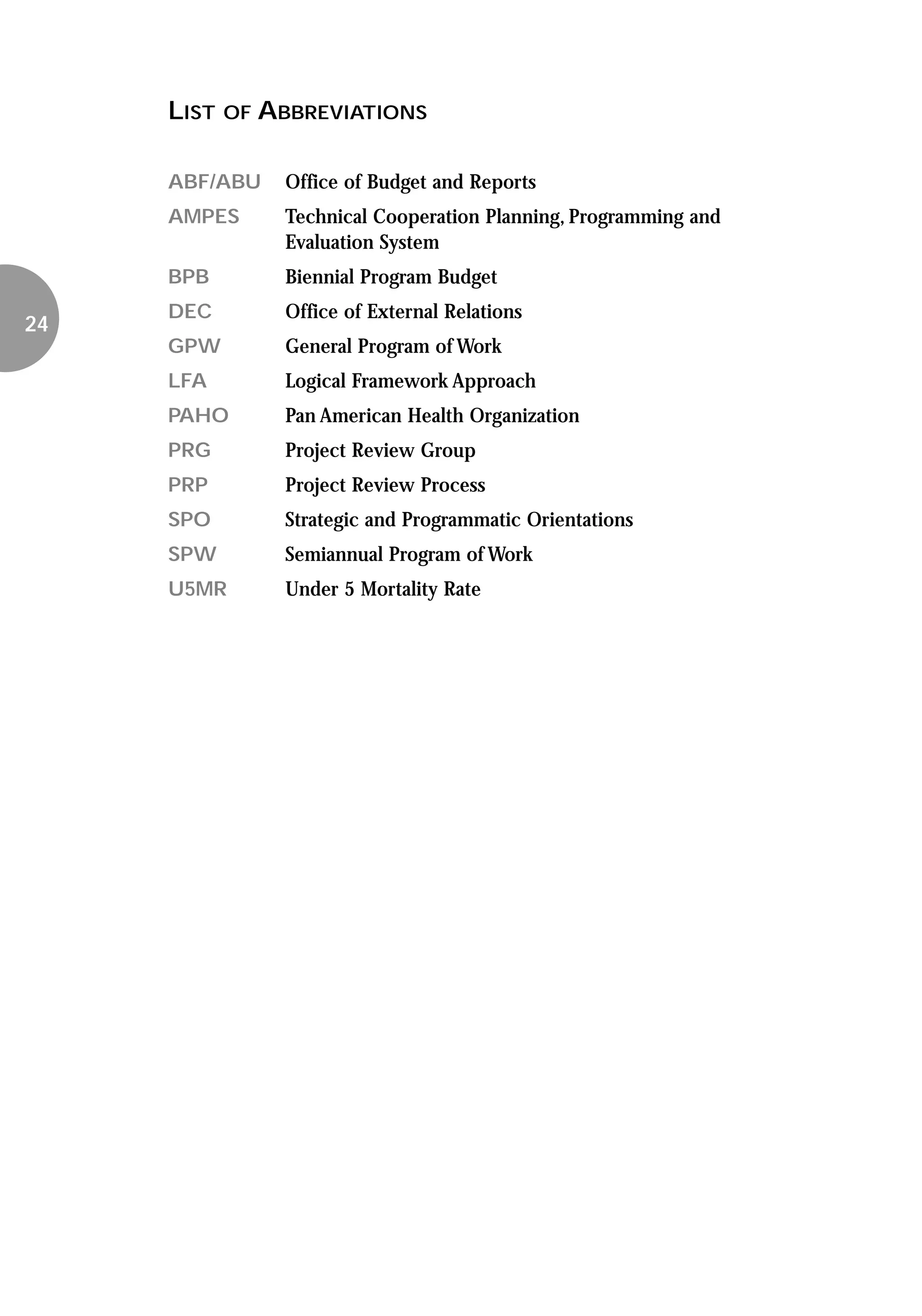

LIST OF ABBREVIATIONS
ABF/ABU Office of Budget and Reports
AMPES Technical Cooperation Planning, Programming and
Evaluation System
BPB Biennial Program Budget
DEC Office of External Relations
GPW General Program of Work
LFA Logical Framework Approach
PAHO Pan American Health Organization
PRG Project Review Group
PRP Project Review Process
SPO Strategic and Programmatic Orientations
SPW Semiannual Program of Work
U5MR Under 5 Mortality Rate
Monitoring of Project Implem.3 11/3/00 10:40 AM Page 24
29. Office of External Relations
Pan American Health Organization
Pan American Sanitary Bureau, Regional Office of the
World Health Organization
525 Twenty-third Street, N.W. 20037, U.S.A.
February 1999 P a n A m e r i c a n H e a l t h O r g a n i z a t i o n
o 10 20 30 40 50 60 70 80 90 100
PROJECT IMPLEMENTATION
a manual
MONITORING of
Monitoring Cover Final.qxd 11/3/00 10:42 AM Page 1
