GIP Frame work
                             Q2 2013

1. General information.
2. Timeline of actions.
3. MC-LC responsibilities.
4. Education for GIP members.
5. Branding.
6. Recommended finance and structures (inputs for TMs).
7. Tracking System.
8. Reward and Recognition System.
9. Inputs for planning projects.
10. Useful links.

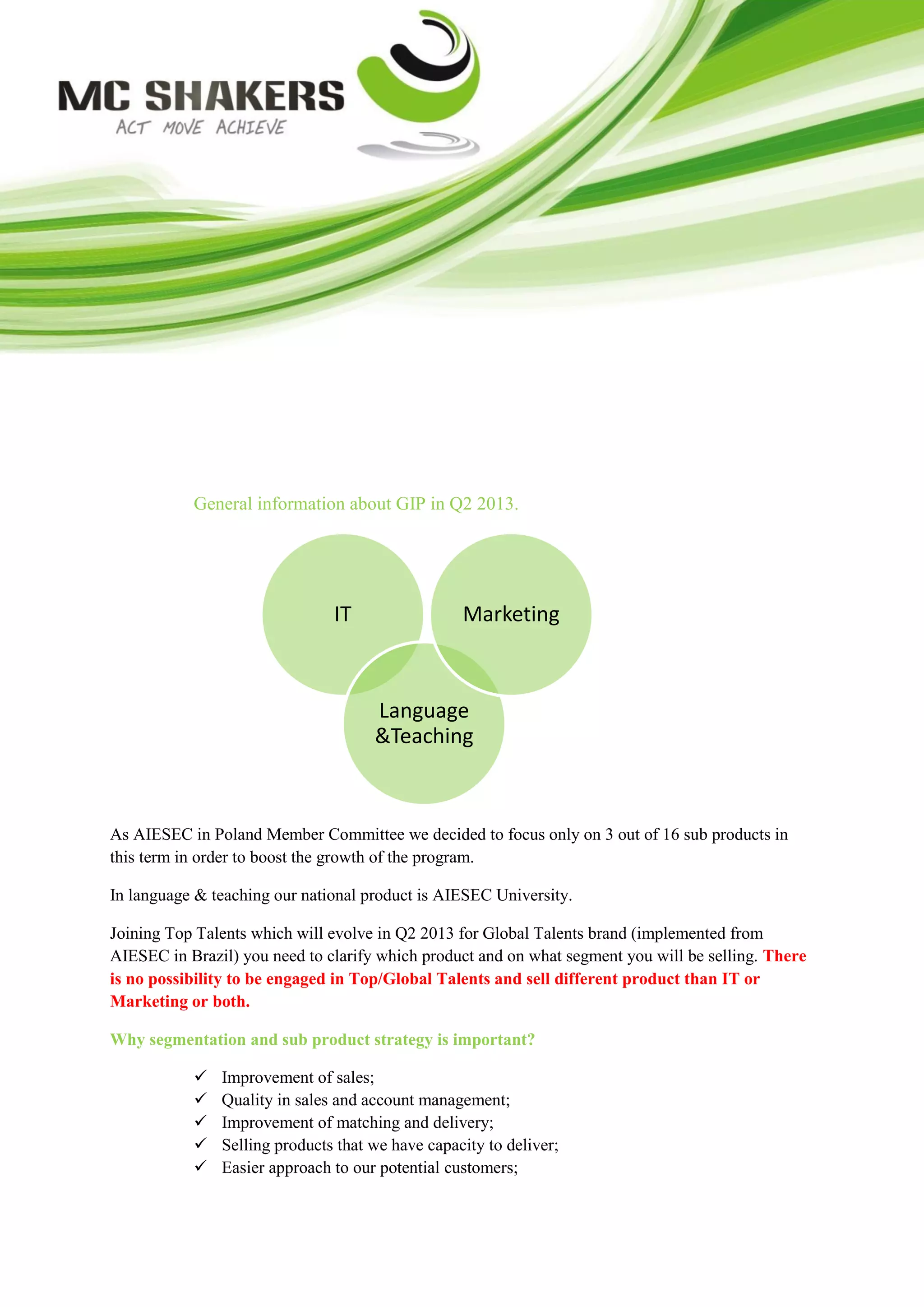

General information about GIP in Q2 2013.

                               IT                 Marketing

                                     Language
                                     &Teaching

As AIESEC in Poland Member Committee we decided to focus only on 3 out of 16 sub products in
this term in order to boost the growth of the program.

In language & teaching our national product is AIESEC University.

Joining Top Talents which will evolve in Q2 2013 for Global Talents brand (implemented from
AIESEC in Brazil) you need to clarify which product and on what segment you will be selling. There
is no possibility to be engaged in Top/Global Talents and sell different product than IT or
Marketing or both.

Why segmentation and sub product strategy is important?

              Improvement of sales;
              Quality in sales and account management;
              Improvement of matching and delivery;
              Selling products that we have capacity to deliver;
              Easier approach to our potential customers;
 Easier branding of product

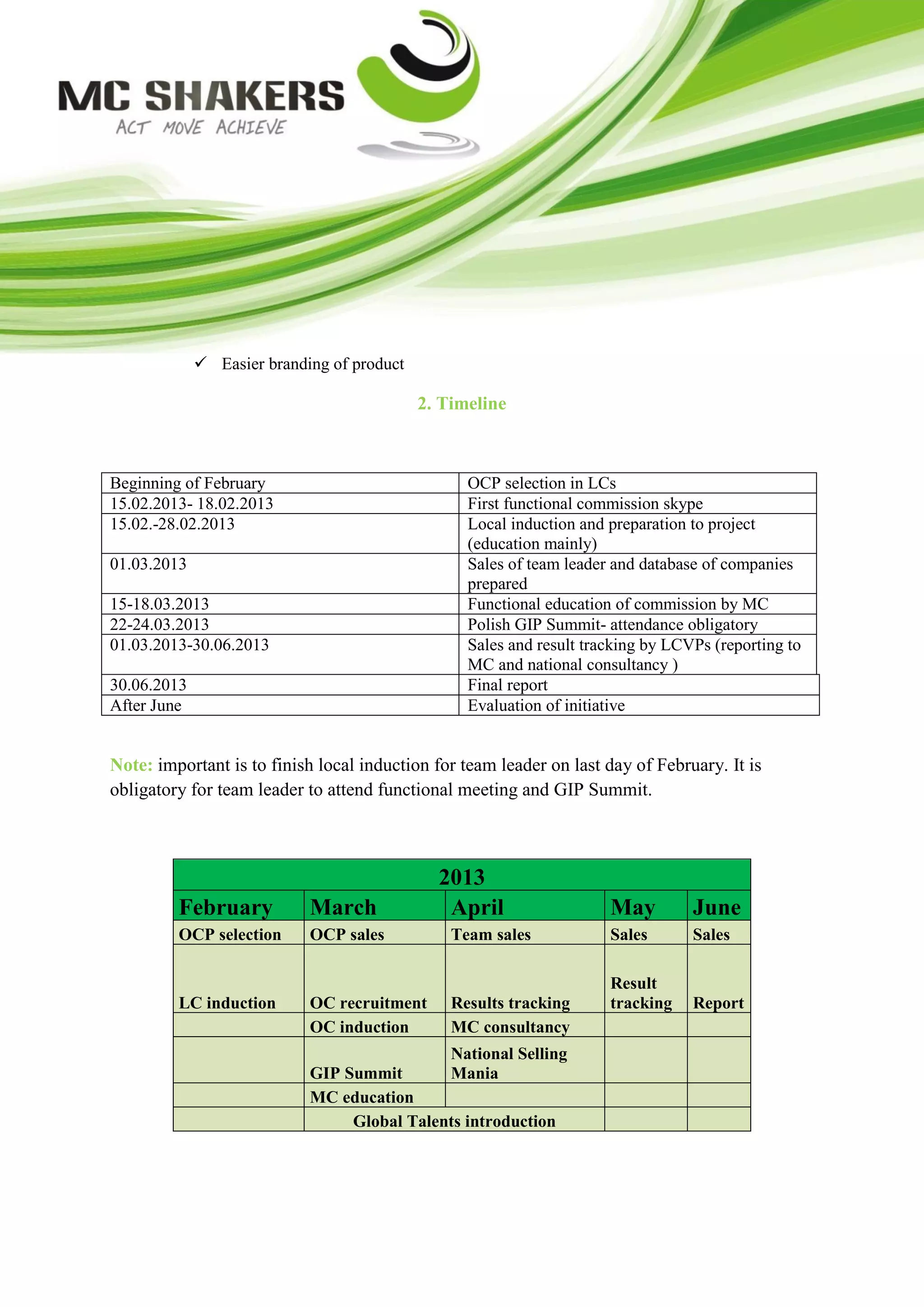

                                            2. Timeline

Beginning of February                             OCP selection in LCs
15.02.2013- 18.02.2013                            First functional commission skype
15.02.-28.02.2013                                 Local induction and preparation to project
                                                  (education mainly)
01.03.2013                                        Sales of team leader and database of companies
                                                  prepared
15-18.03.2013                                     Functional education of commission by MC
22-24.03.2013                                     Polish GIP Summit- attendance obligatory
01.03.2013-30.06.2013                             Sales and result tracking by LCVPs (reporting to
                                                  MC and national consultancy )
30.06.2013                                        Final report
After June                                        Evaluation of initiative

Note: important is to finish local induction for team leader on last day of February. It is
obligatory for team leader to attend functional meeting and GIP Summit.

                                              2013
         February           March              April                  May         June
         OCP selection      OCP sales           Team sales            Sales       Sales

                                                                      Result
         LC induction       OC recruitment      Results tracking      tracking    Report
                            OC induction        MC consultancy
                                             National Selling
                            GIP Summit       Mania
                            MC education
                                 Global Talents introduction

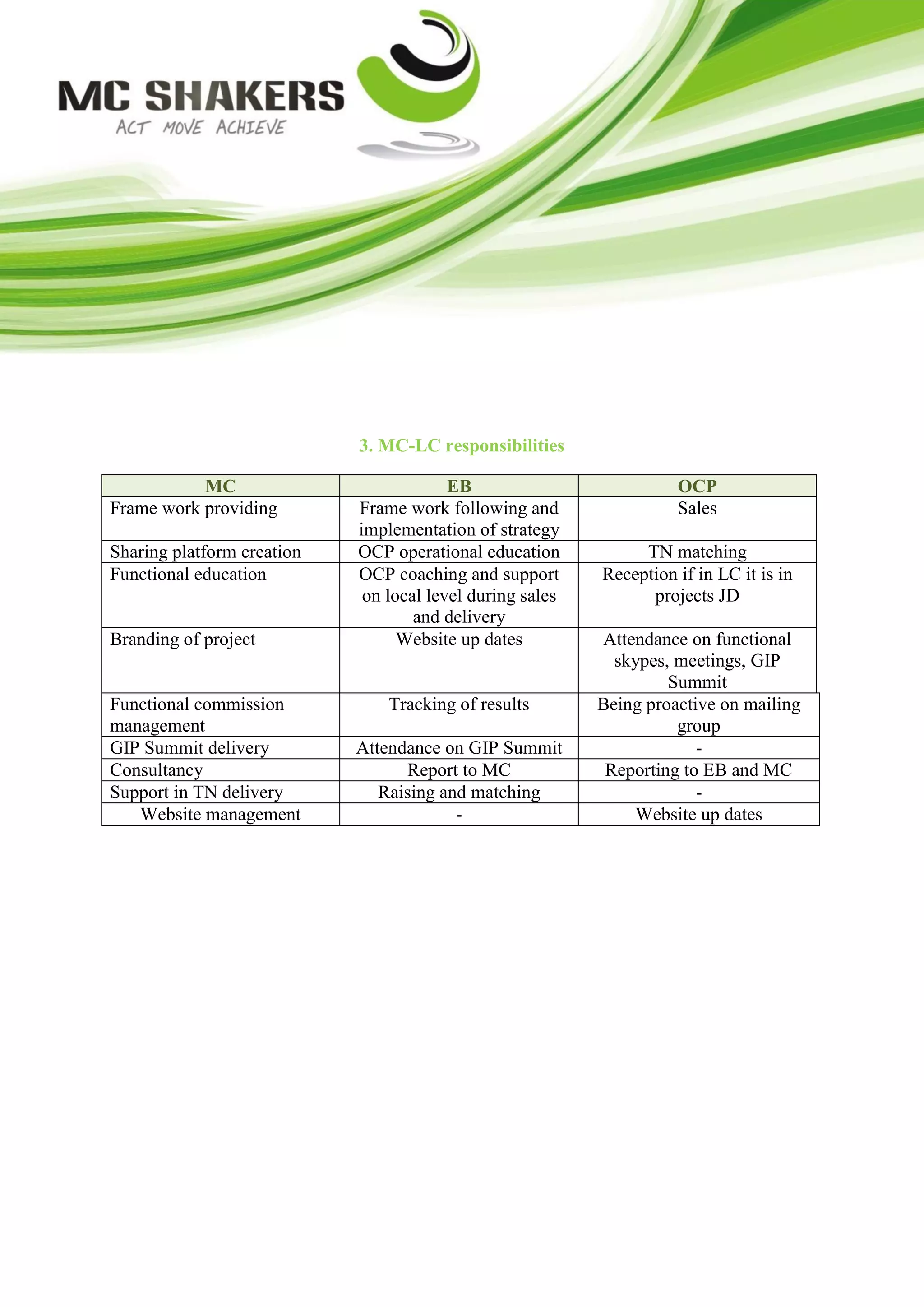

3. MC-LC responsibilities

           MC                            EB                          OCP
Frame work providing        Frame work following and                 Sales
                            implementation of strategy
Sharing platform creation   OCP operational education           TN matching
Functional education        OCP coaching and support       Reception if in LC it is in
                             on local level during sales         projects JD
                                    and delivery
Branding of project               Website up dates         Attendance on functional
                                                             skypes, meetings, GIP
                                                                    Summit
Functional commission           Tracking of results        Being proactive on mailing
management                                                           group
GIP Summit delivery         Attendance on GIP Summit                    -
Consultancy                       Report to MC              Reporting to EB and MC
Support in TN delivery         Raising and matching                     -
   Website management                    -                     Website up dates

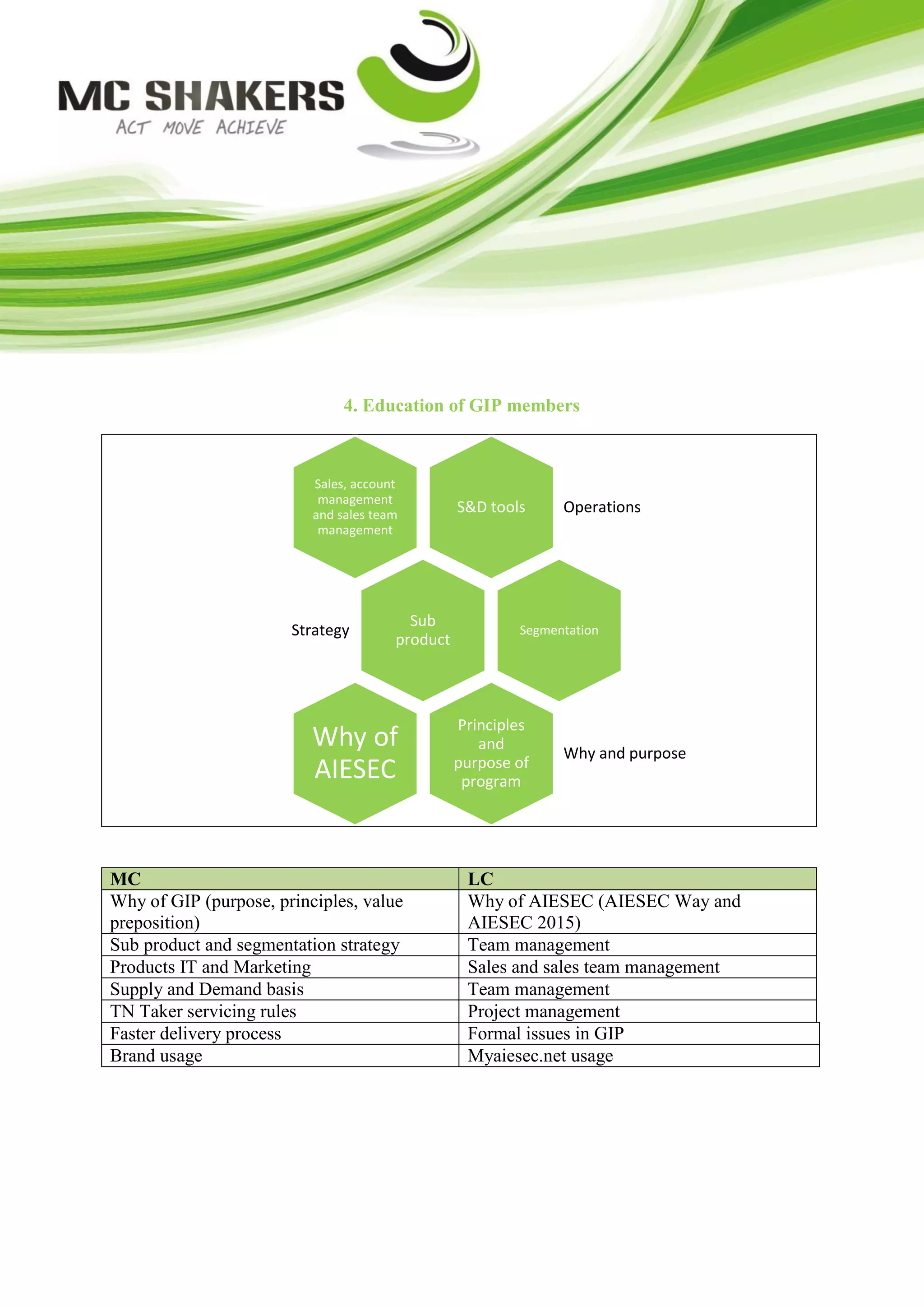

4. Education of GIP members

                          Sales, account
                           management
                          and sales team         S&D tools     Operations
                           management

                                         Sub
                       Strategy                          Segmentation
                                       product

                                                 Principles
                          Why of                    and
                                                               Why and purpose
                                                 purpose of
                          AIESEC                  program

MC                                                LC
Why of GIP (purpose, principles, value            Why of AIESEC (AIESEC Way and
preposition)                                      AIESEC 2015)
Sub product and segmentation strategy             Team management
Products IT and Marketing                         Sales and sales team management
Supply and Demand basis                           Team management
TN Taker servicing rules                          Project management
Faster delivery process                           Formal issues in GIP
Brand usage                                       Myaiesec.net usage

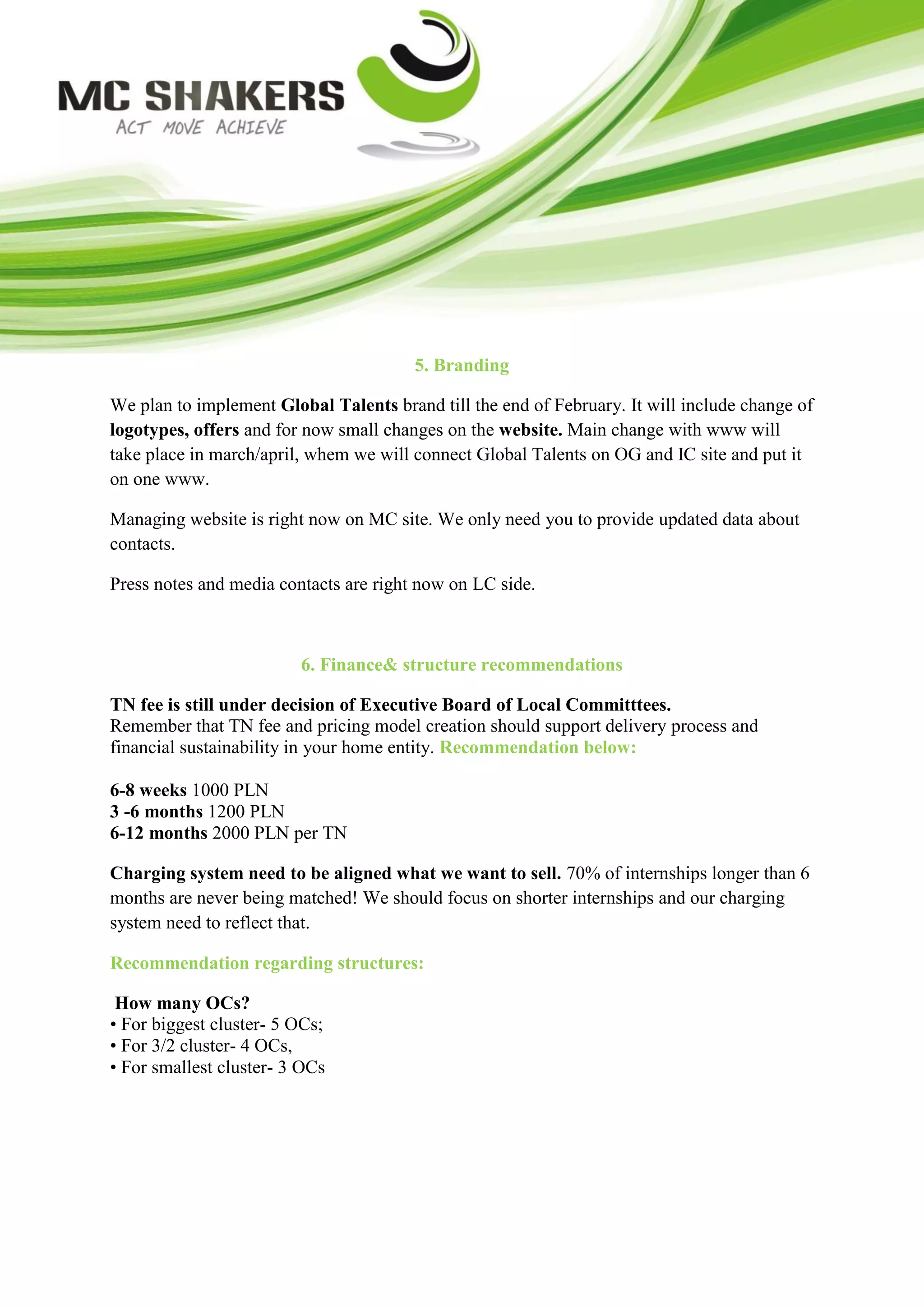

5. Branding

We plan to implement Global Talents brand till the end of February. It will include change of
logotypes, offers and for now small changes on the website. Main change with www will
take place in march/april, whem we will connect Global Talents on OG and IC site and put it
on one www.

Managing website is right now on MC site. We only need you to provide updated data about
contacts.

Press notes and media contacts are right now on LC side.

                         6. Finance& structure recommendations

TN fee is still under decision of Executive Board of Local Committtees.
Remember that TN fee and pricing model creation should support delivery process and
financial sustainability in your home entity. Recommendation below:

6-8 weeks 1000 PLN
3 -6 months 1200 PLN
6-12 months 2000 PLN per TN

Charging system need to be aligned what we want to sell. 70% of internships longer than 6
months are never being matched! We should focus on shorter internships and our charging
system need to reflect that.

Recommendation regarding structures:

 How many OCs?
• For biggest cluster- 5 OCs;
• For 3/2 cluster- 4 OCs,
• For smallest cluster- 3 OCs

OCP

                      OC              OC            OC

General recommendation: no OCVPs in project.

                                    7. Tracking System

All of the LCs are obliged to up date National Sales Tracking Tool every month.

Why?

      Gathering sales data;
      Research about sales effectiveness;
      Bottleneck finder;
      Improving of sales processes

Rules of usage:

Weekly up date checked by MC.

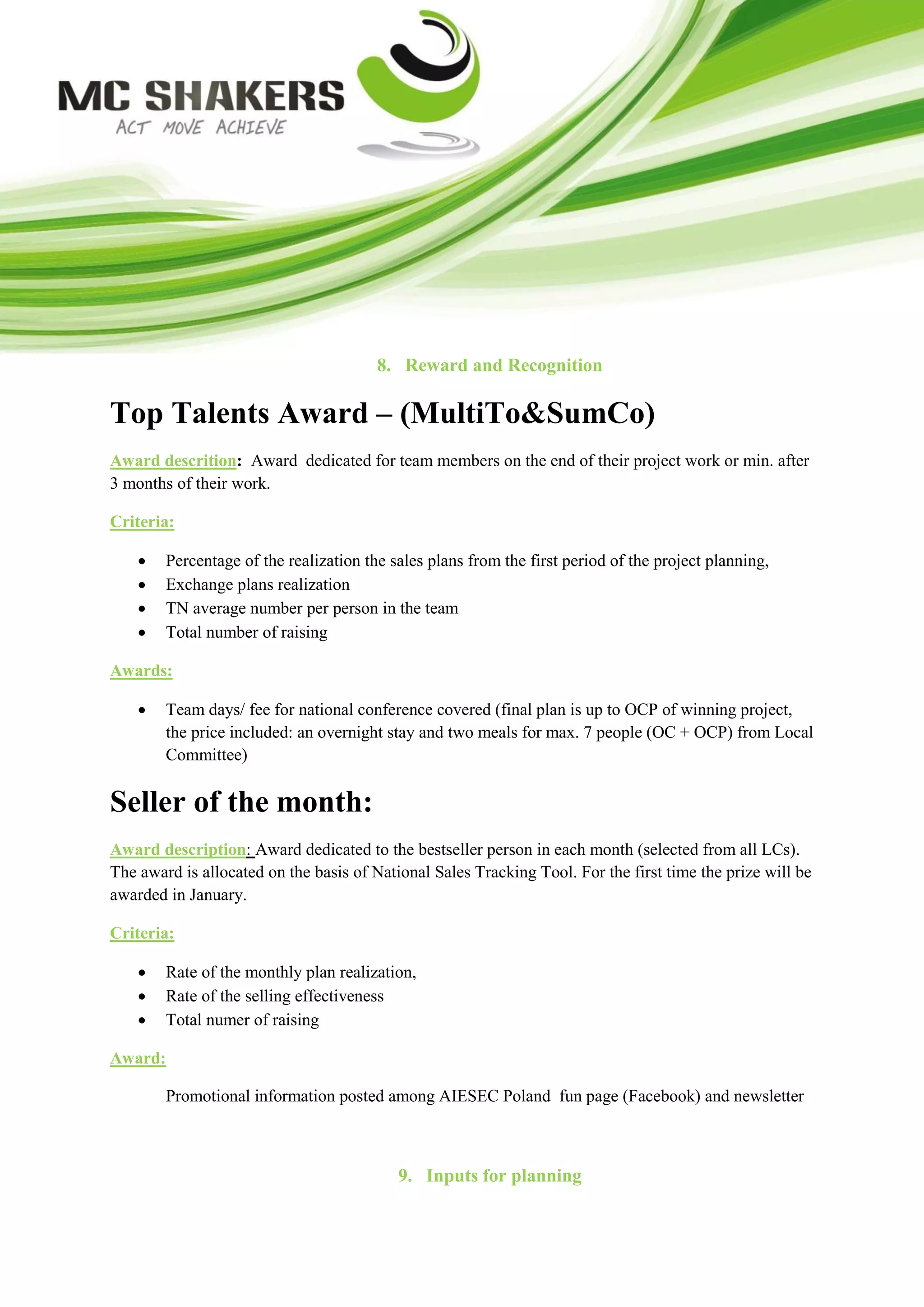

8. Reward and Recognition

Top Talents Award – (MultiTo&SumCo)
Award descrition: Award dedicated for team members on the end of their project work or min. after
3 months of their work.

Criteria:

       Percentage of the realization the sales plans from the first period of the project planning,
       Exchange plans realization
       TN average number per person in the team
       Total number of raising

Awards:

       Team days/ fee for national conference covered (final plan is up to OCP of winning project,
        the price included: an overnight stay and two meals for max. 7 people (OC + OCP) from Local
        Committee)

Seller of the month:
Award description: Award dedicated to the bestseller person in each month (selected from all LCs).
The award is allocated on the basis of National Sales Tracking Tool. For the first time the prize will be
awarded in January.

Criteria:

       Rate of the monthly plan realization,
       Rate of the selling effectiveness
       Total numer of raising

Award:

        Promotional information posted among AIESEC Poland fun page (Facebook) and newsletter

                                           9. Inputs for planning

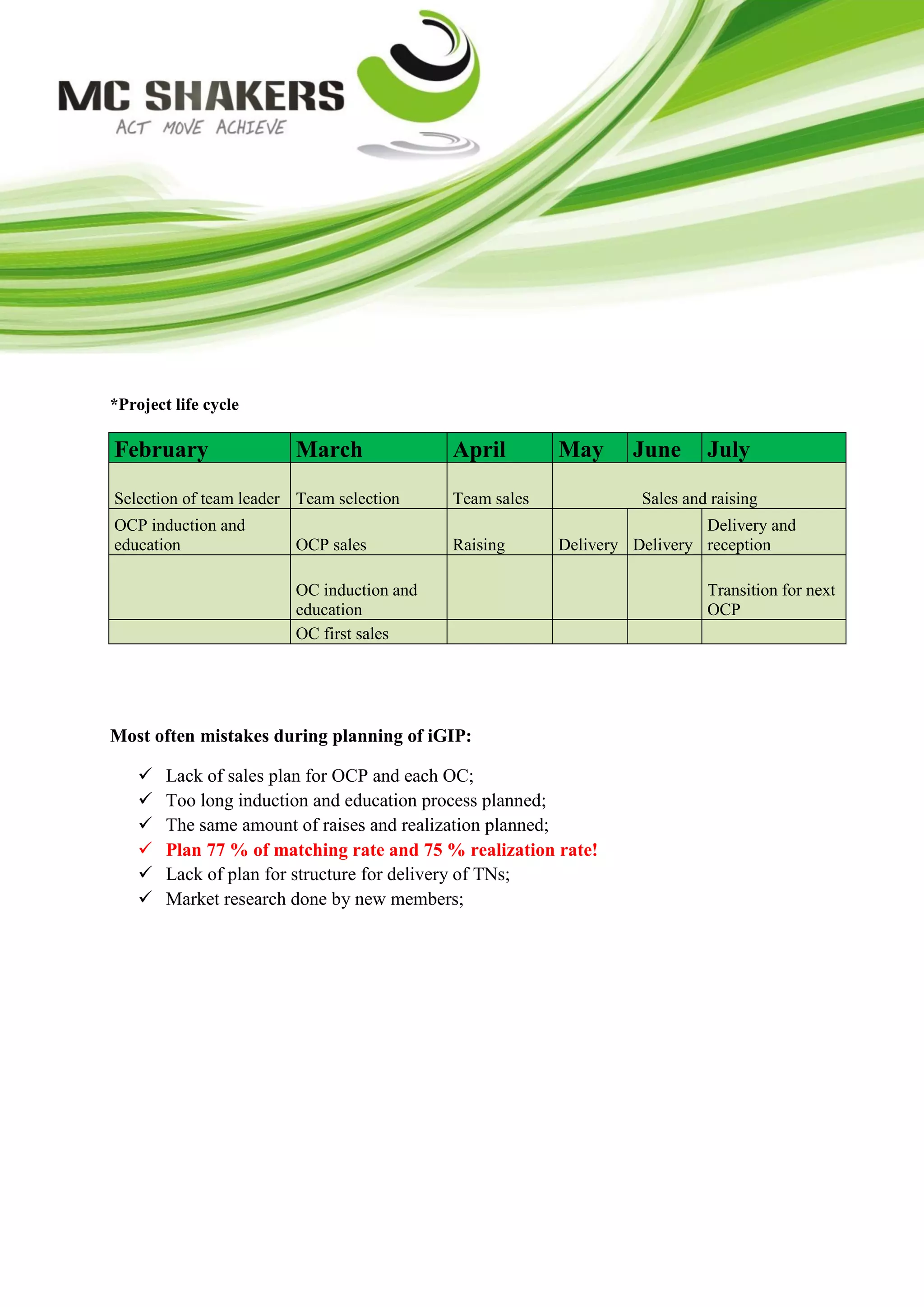

*Project life cycle

February                March              April        May      June      July

Selection of team leader Team selection    Team sales             Sales and raising
OCP induction and                                                         Delivery and
education               OCP sales          Raising      Delivery Delivery reception

                        OC induction and                                   Transition for next
                        education                                          OCP
                        OC first sales

Most often mistakes during planning of iGIP:

       Lack of sales plan for OCP and each OC;
       Too long induction and education process planned;
       The same amount of raises and realization planned;
       Plan 77 % of matching rate and 75 % realization rate!
       Lack of plan for structure for delivery of TNs;
       Market research done by new members;

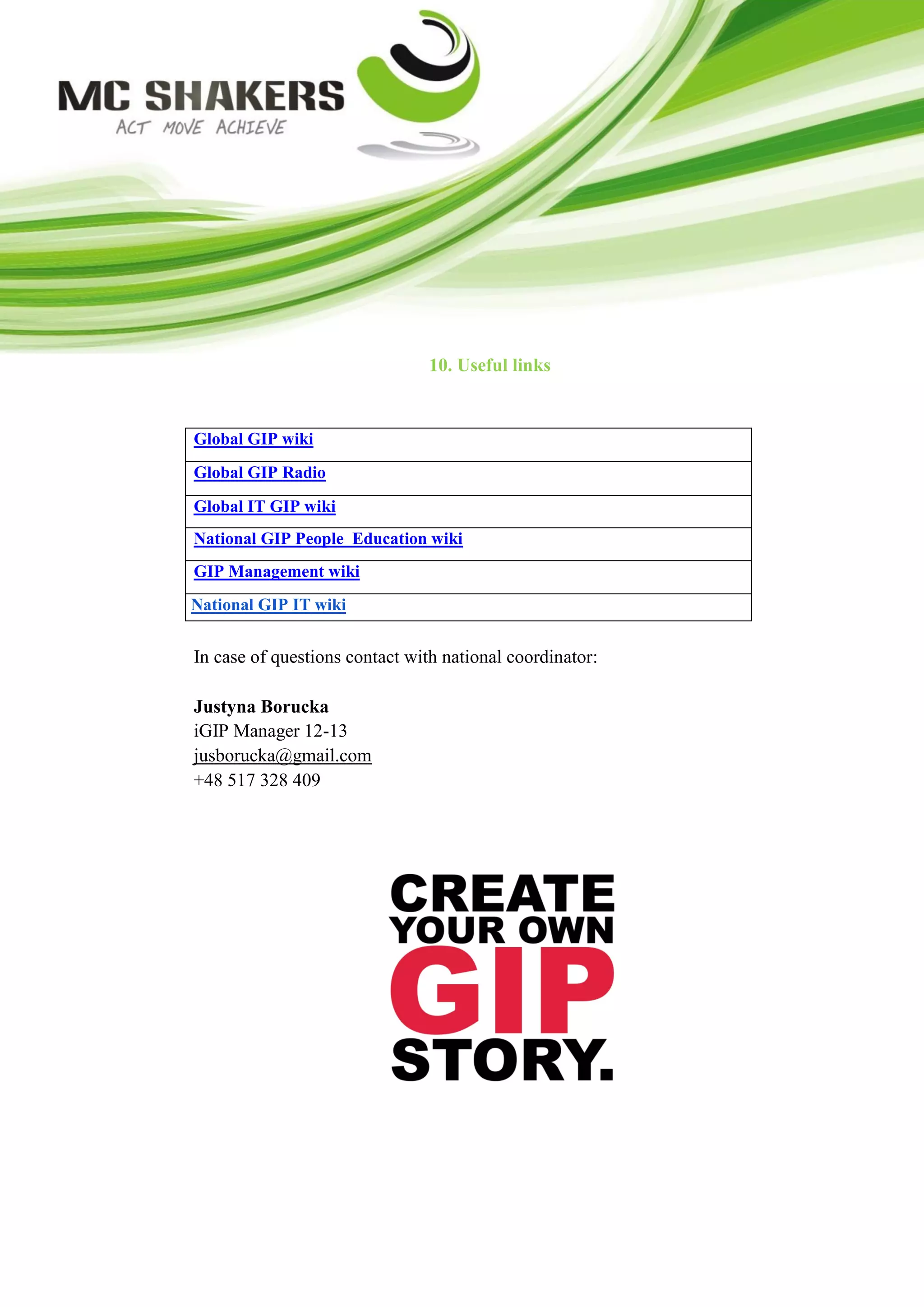

10. Useful links

Global GIP wiki
Global GIP Radio
Global IT GIP wiki
National GIP People Education wiki
GIP Management wiki
National GIP IT wiki

In case of questions contact with national coordinator:

Justyna Borucka
iGIP Manager 12-13
jusborucka@gmail.com
+48 517 328 409
