Pharmaceutical Project Portfolio Management
Comparison of Microsoft EPM vs. Primavera P6 v7
Sarah Benjamin
Taurus Project Controls
April 2012
The Agenda
Speaker
Types of Projects
Transition from Manual Tracking into Enterprise Tool
Dimensions
Project Prioritization
Budget Management for the Portfolio
Resource Management
Speaker
Sarah Benjamin
Project Scheduler
Primavera P6 v7 Web Lead
Project Portfolio Manager
Consultant
Email: sbenjamin@tauruspcc.com
Linked In: http://www.linkedin.com/in/sarahbenjamin

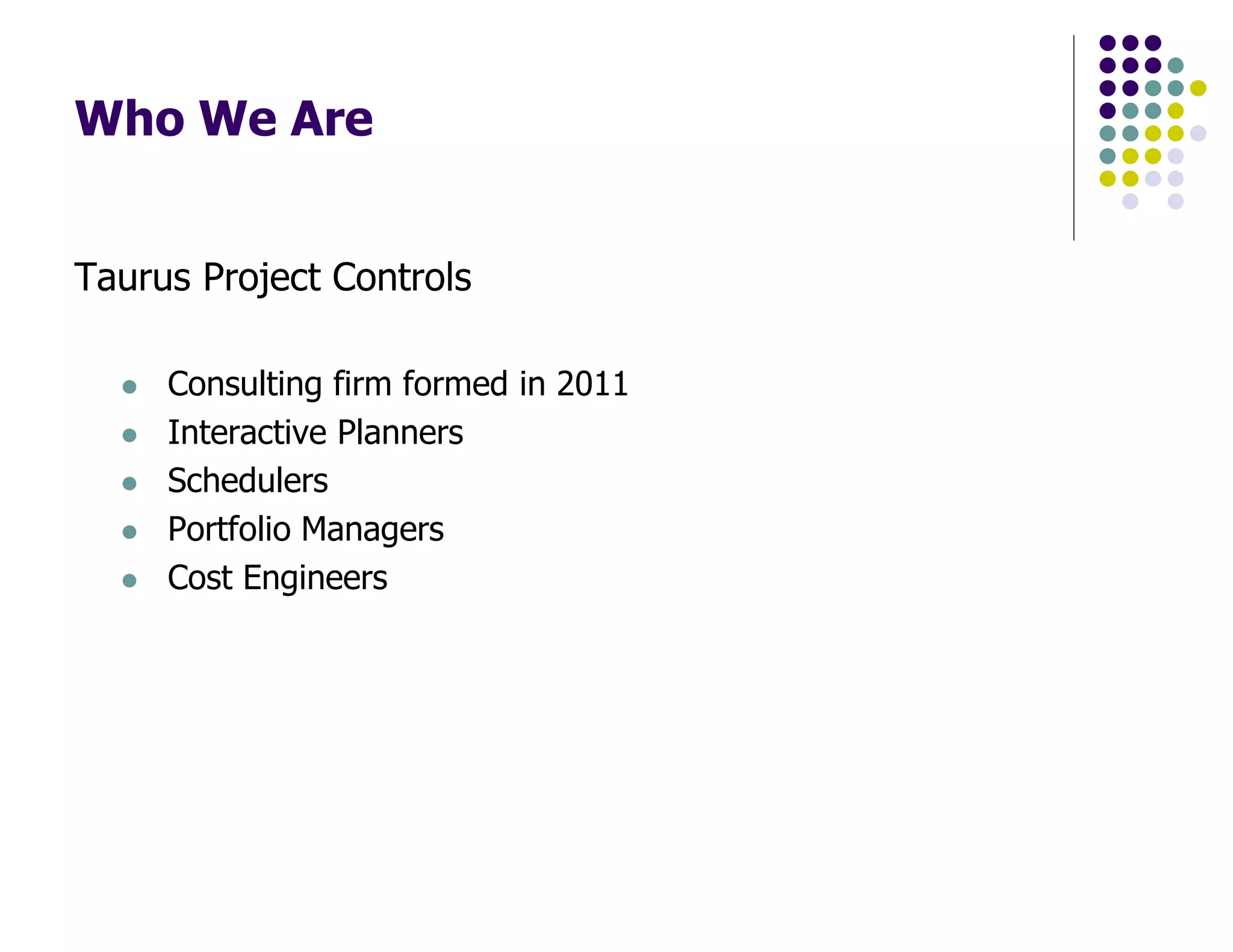

Who We Are
Taurus Project Controls
Consulting firm formed in 2011
Interactive Planners
Schedulers
Portfolio Managers
Cost Engineers

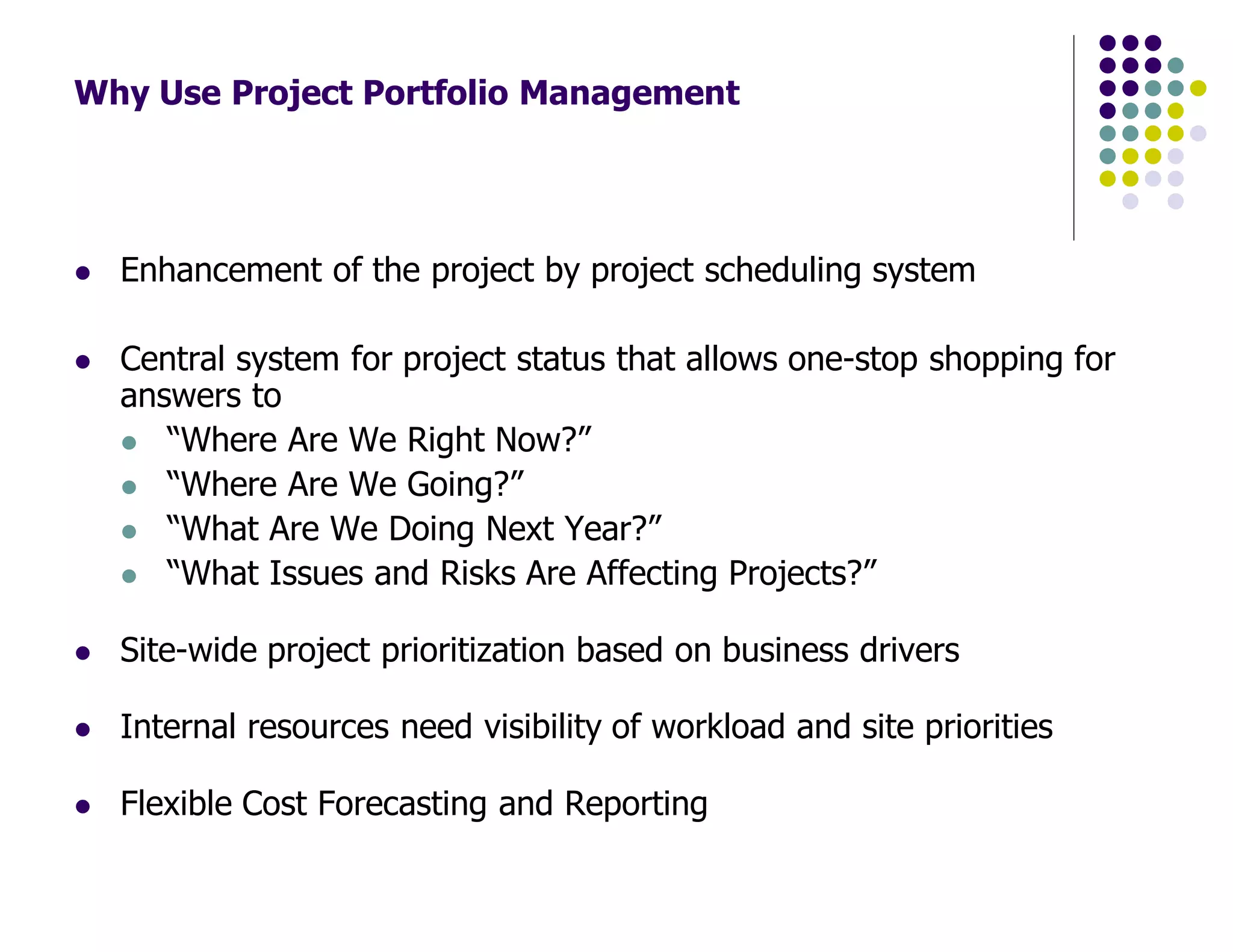

Why Use Project Portfolio Management
Enhancement of the project by project scheduling system
Central system for project status that allows one-stop shopping for
answers to
“Where Are We Right Now?”
“Where Are We Going?”
“What Are We Doing Next Year?”
“What Issues and Risks Are Affecting Projects?”
Site-wide project prioritization based on business drivers
Internal resources need visibility of workload and site priorities
Flexible Cost Forecasting and Reporting

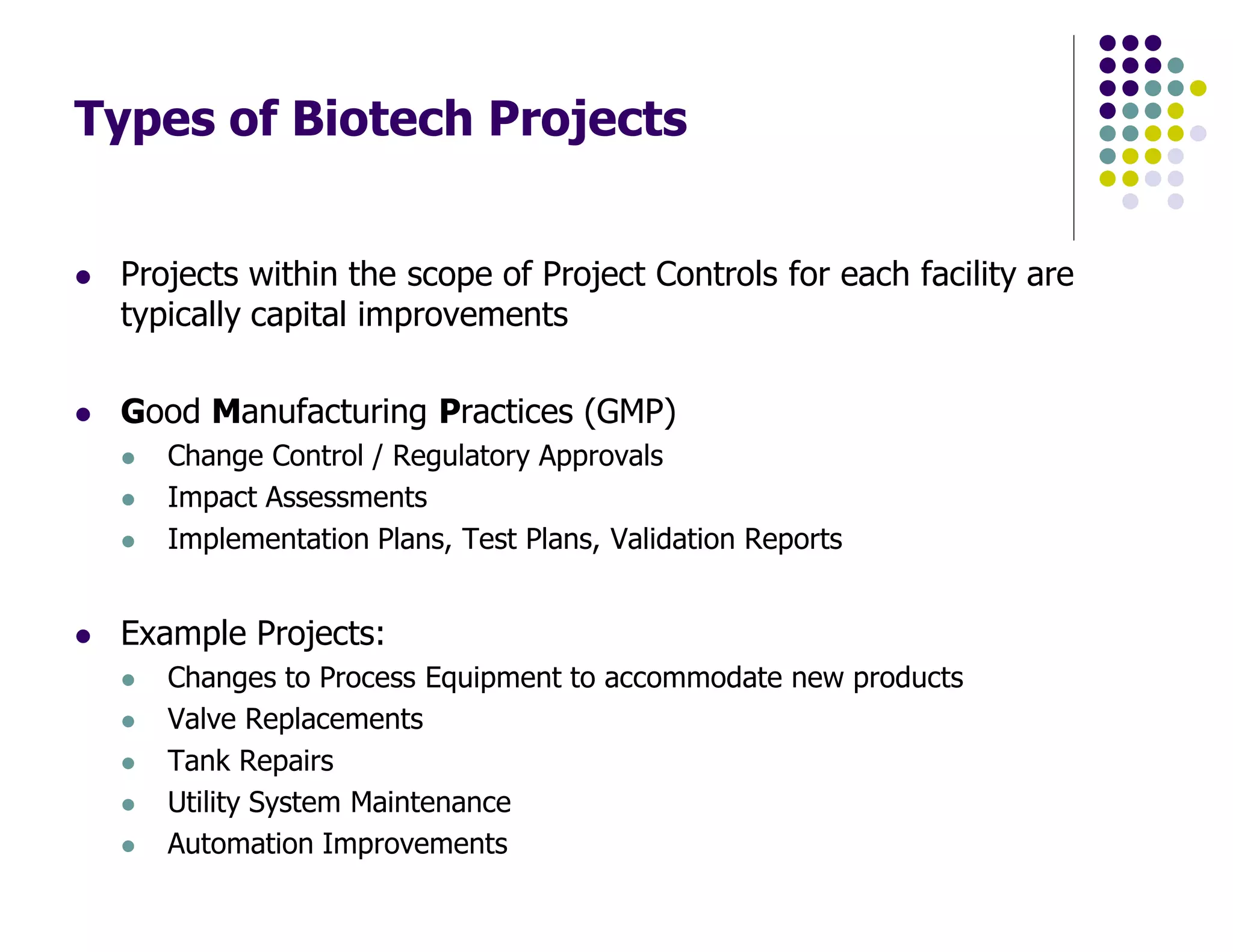

Types of Biotech Projects
Projects within the scope of Project Controls for each facility are
typically capital improvements
Good Manufacturing Practices (GMP)
Change Control / Regulatory Approvals
Impact Assessments
Implementation Plans, Test Plans, Validation Reports
Example Projects:
Changes to Process Equipment to accommodate new products
Valve Replacements
Tank Repairs
Utility System Maintenance
Automation Improvements

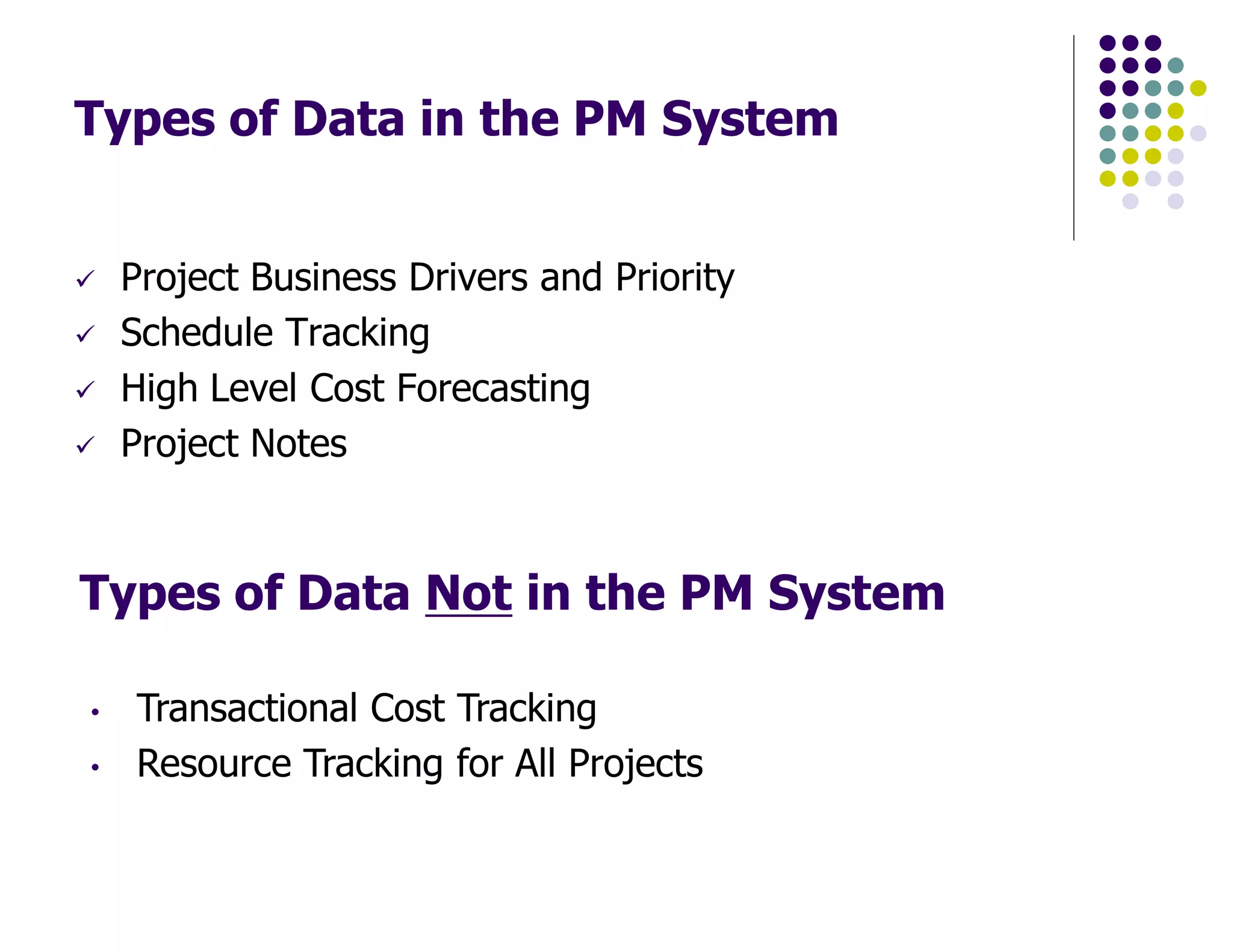

Types of Data in the PM System
Project Business Drivers and Priority
Schedule Tracking
High Level Cost Forecasting
Project Notes
Types of Data Not in the PM System
• Transactional Cost Tracking
• Resource Tracking for All Projects

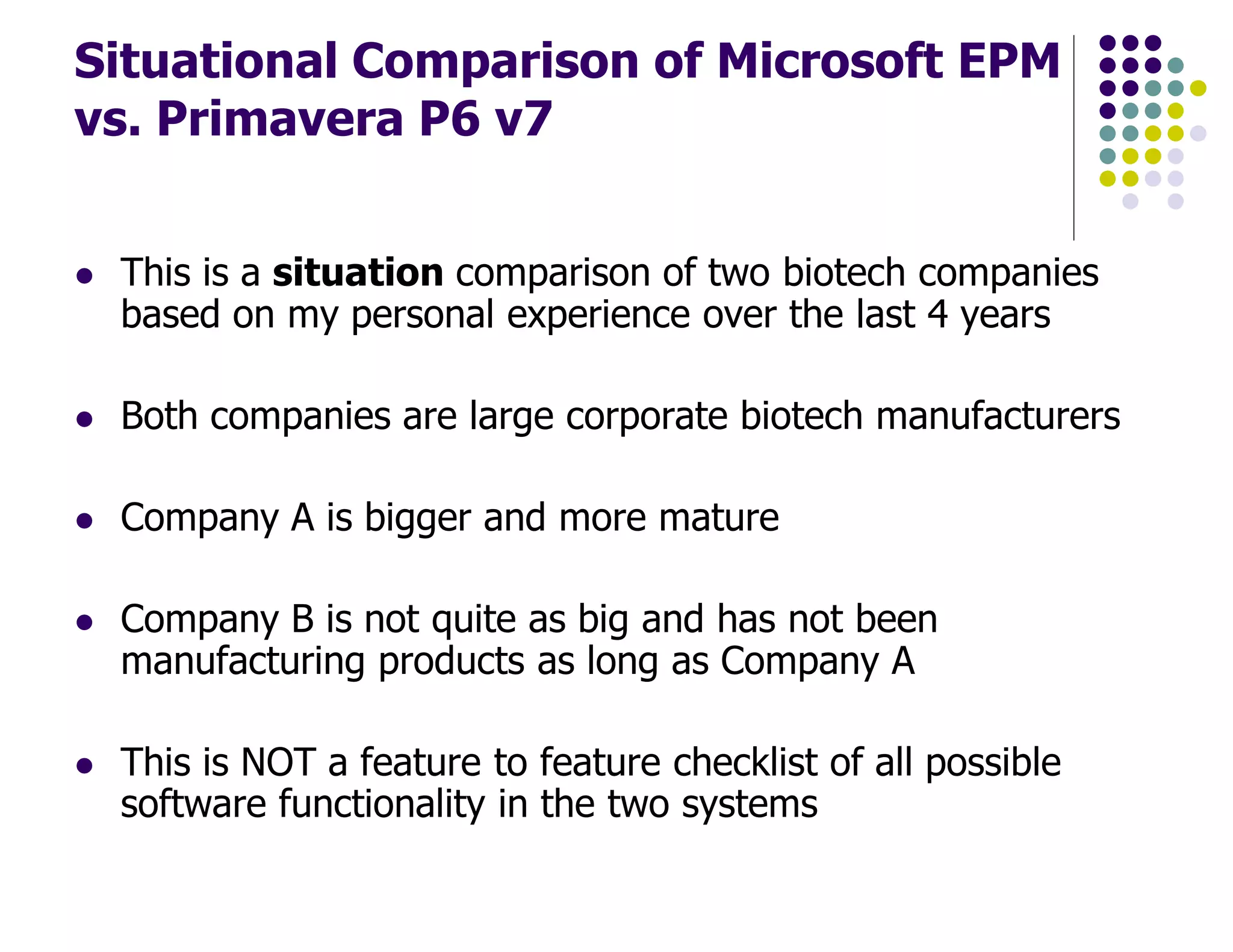

Situational Comparison of Microsoft EPM
vs. Primavera P6 v7
This is a situation comparison of two biotech companies
based on my personal experience over the last 4 years
Both companies are large corporate biotech manufacturers
Company A is bigger and more mature
Company B is not quite as big and has not been
manufacturing products as long as Company A
This is NOT a feature to feature checklist of all possible
software functionality in the two systems

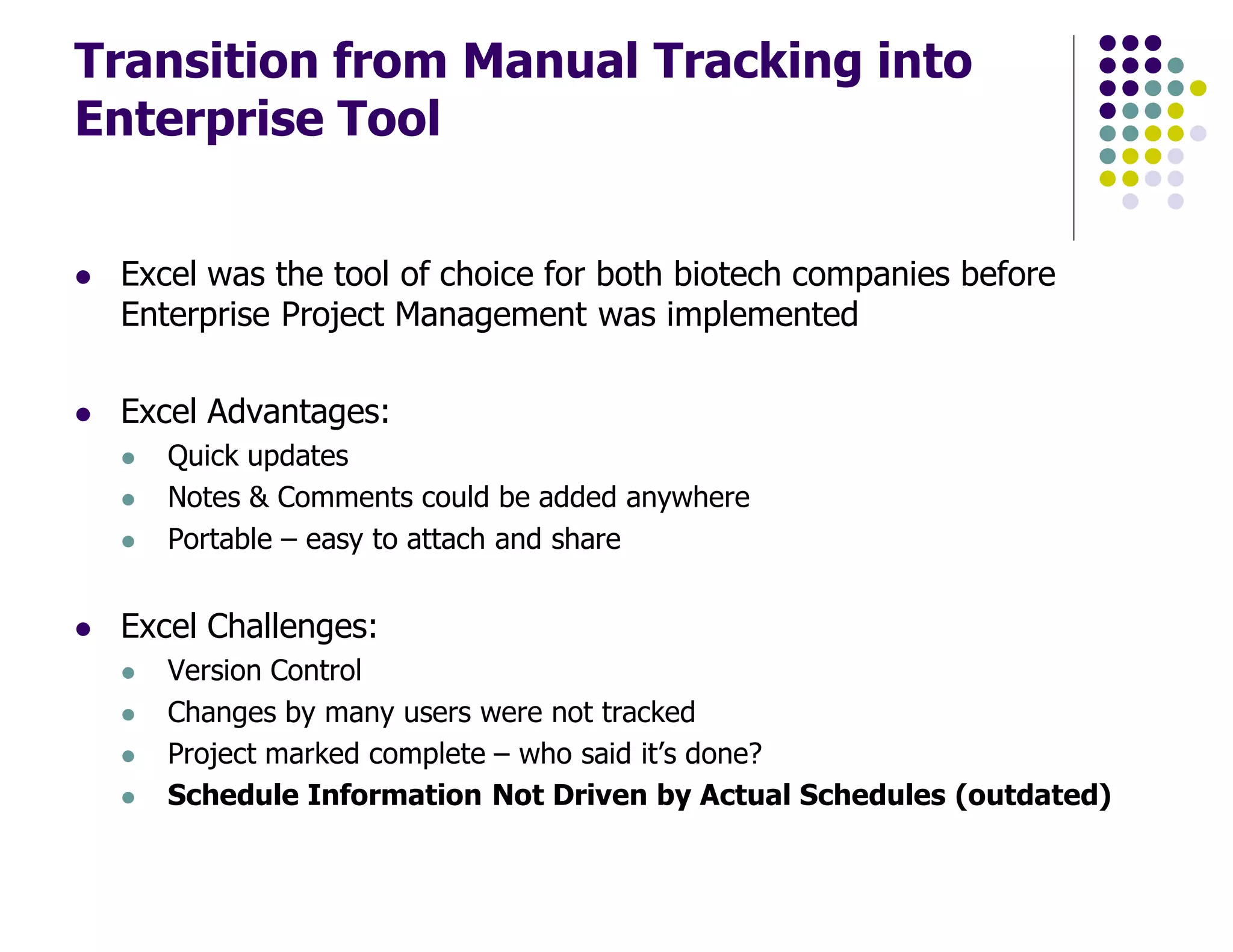

Transition from Manual Tracking into
Enterprise Tool
Excel was the tool of choice for both biotech companies before
Enterprise Project Management was implemented
Excel Advantages:
Quick updates
Notes & Comments could be added anywhere
Portable – easy to attach and share
Excel Challenges:
Version Control
Changes by many users were not tracked
Project marked complete – who said it’s done?
Schedule Information Not Driven by Actual Schedules (outdated)

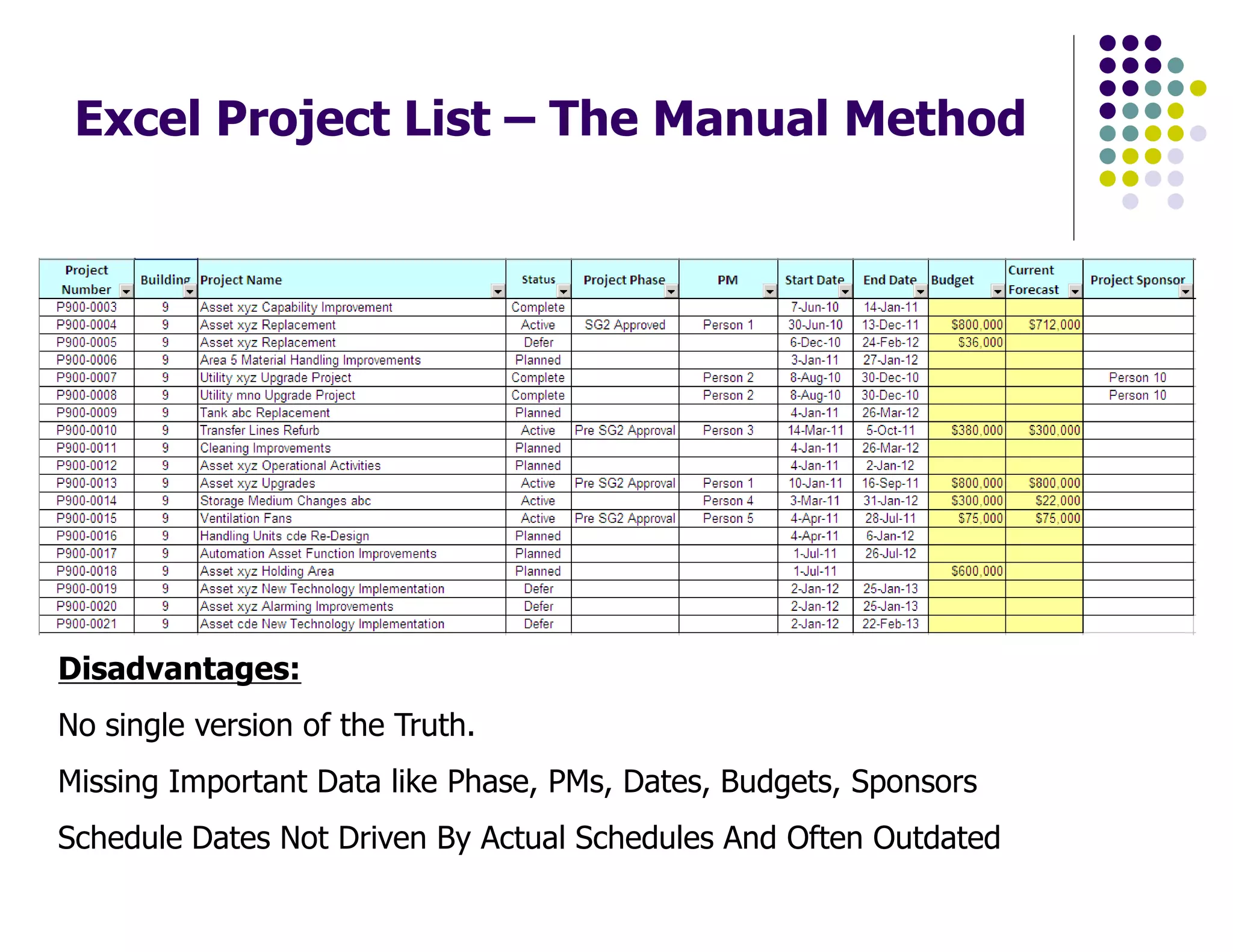

Excel Project List – The Manual Method
Disadvantages:
No single version of the Truth.
Missing Important Data like Phase, PMs, Dates, Budgets, Sponsors
Schedule Dates Not Driven By Actual Schedules And Often Outdated
Enterprise System Architecture
Differences
Company A’s Primavera System Maintained In-House
Speed of System = Fast
Cost per Year < $50k
Speed of System via VPN = Medium
Maintenance/Updates = Slow
IT Support = Slow
Data Loss / Backups = Challenging due to DB restoration process
Reporting Capabilities = Accessible, customizable, non-graphical
Company B’s Microsoft EPM System Hosted Remotely
Speed of System = Slow
Cost per Year > $100k
Speed of System via VPN = Slow (but VPN not required)
Maintenance/Updates = Fast
IT Support = Medium
Data Loss / Backups = Manageable due to Automatic Archive DB
Reporting Capabilities = Challenging, OLAP cubes may need consultant support, graphical

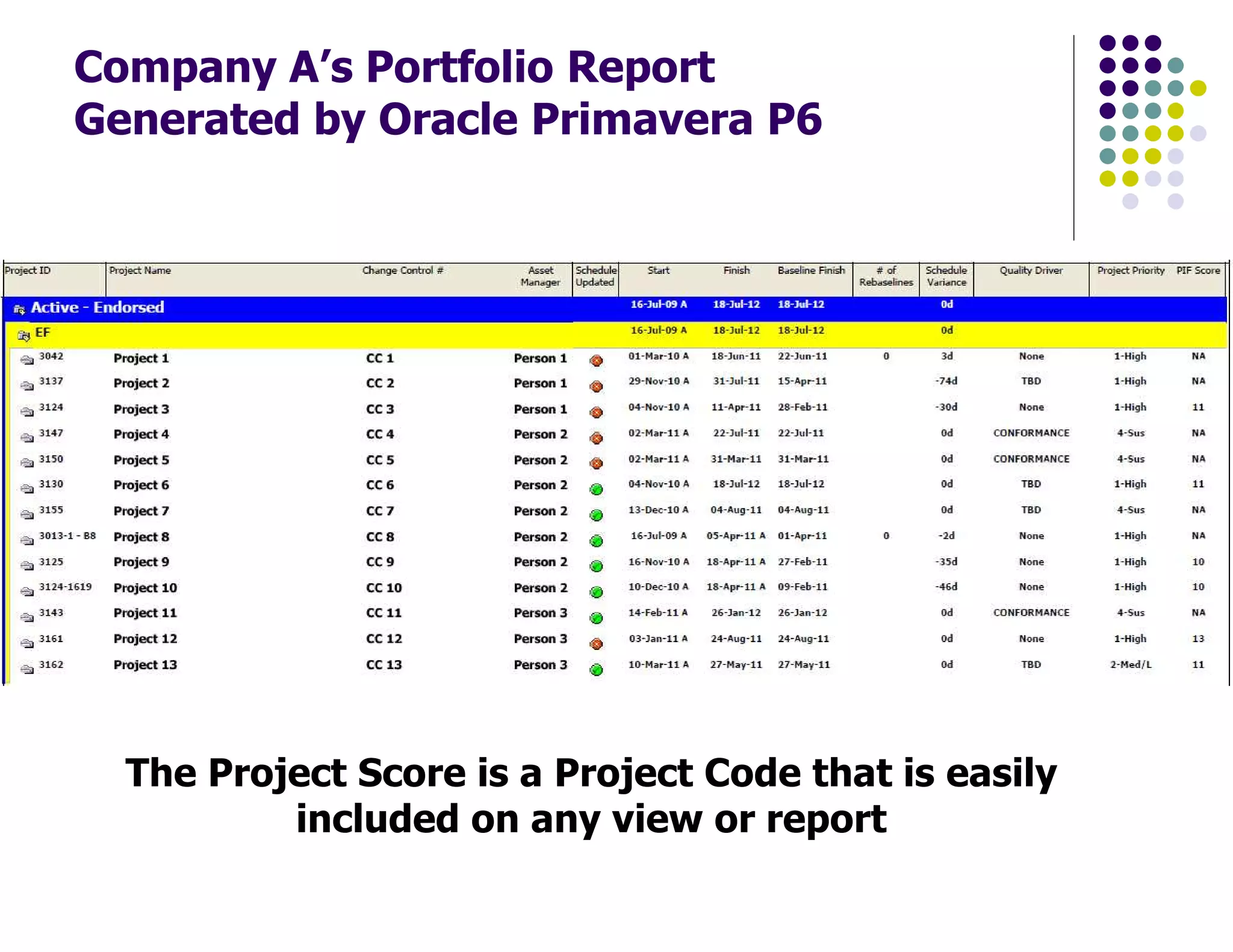

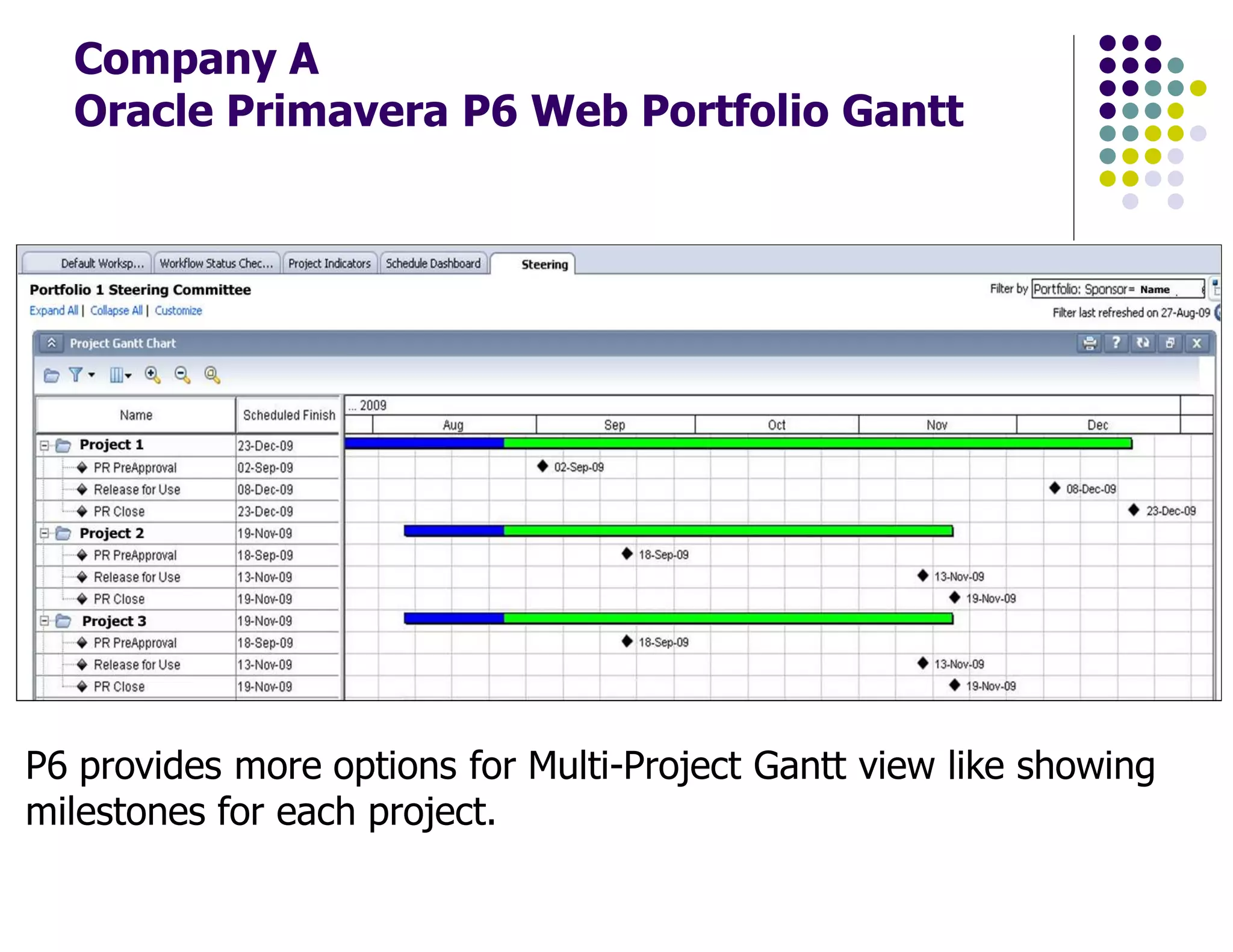

Company A
Oracle Primavera P6 Web Portfolio Gantt
P6 provides more options for Multi-Project Gantt view like showing
milestones for each project.

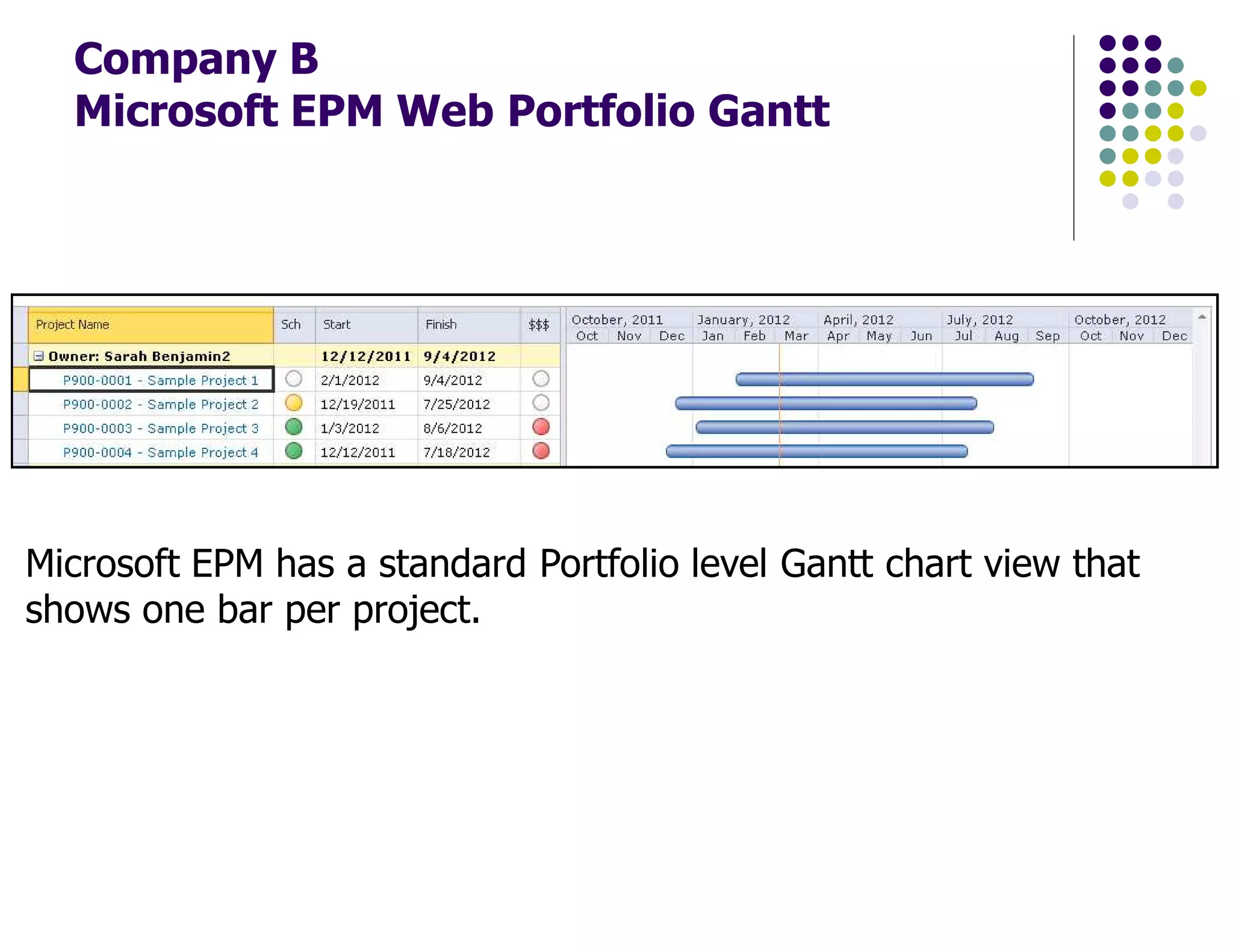

Company B
Microsoft EPM Web Portfolio Gantt
Microsoft EPM has a standard Portfolio level Gantt chart view that
shows one bar per project.
#1 Reason for Project Portfolio Management:
Schedule Management
Centralizing All Project Schedules is the #1 Reason PPM
Systems are Implemented
Schedules can have inter-project links
Schedules are more visible to all users of the software
Schedule updating is more visible to managers
Schedule reporting is simplified
P6 and EPM are Both
Robust Schedule Management Systems
Schedule Management Features Used by Companies A & B:
Inter-project links / logic between activities
Standardized schedule views – output to PDF
Schedule update cycles improved
Schedule reporting provided management a better view
Schedule templates
Activity level coding allowed enterprise level reporting

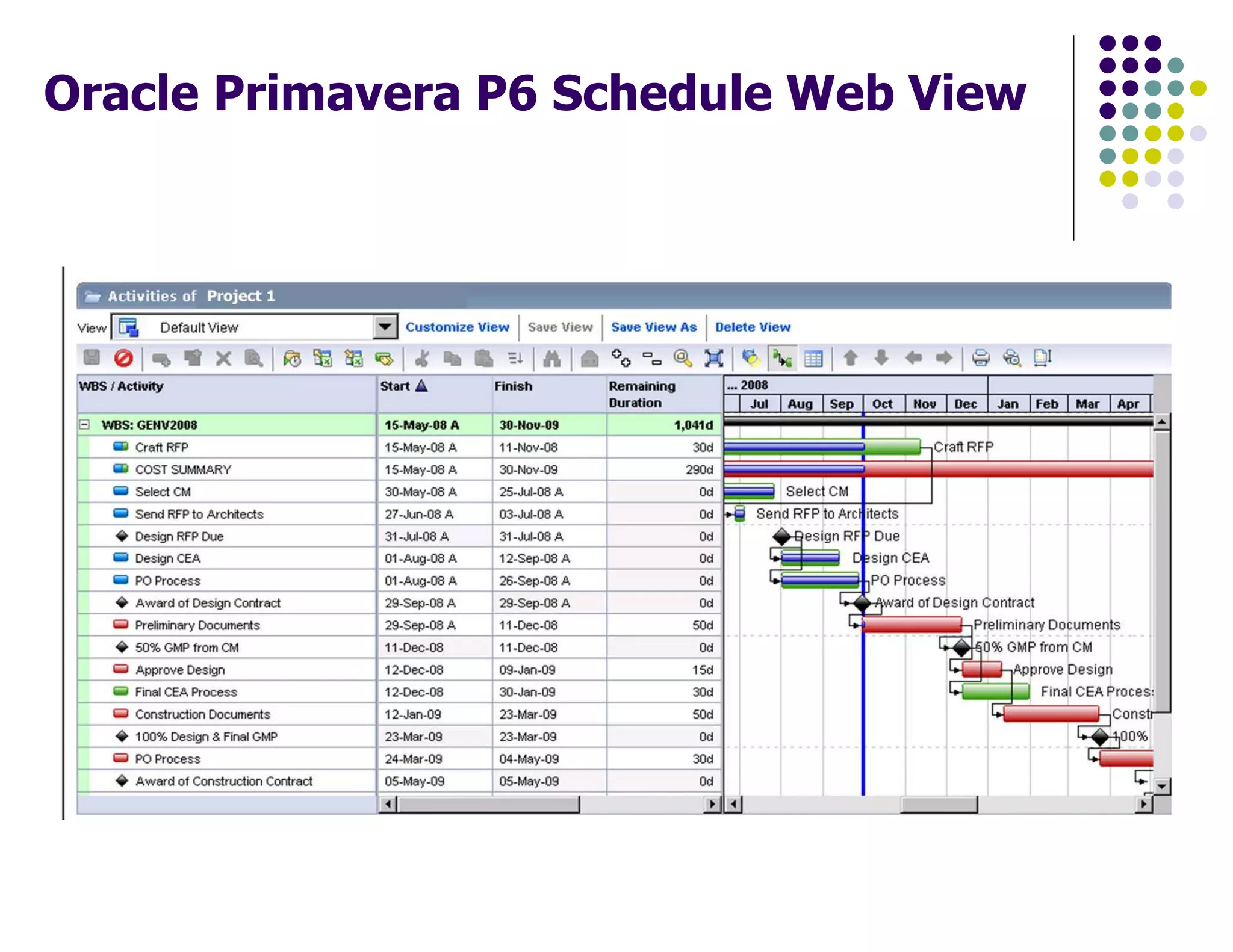

Oracle Primavera P6 Schedule Web View

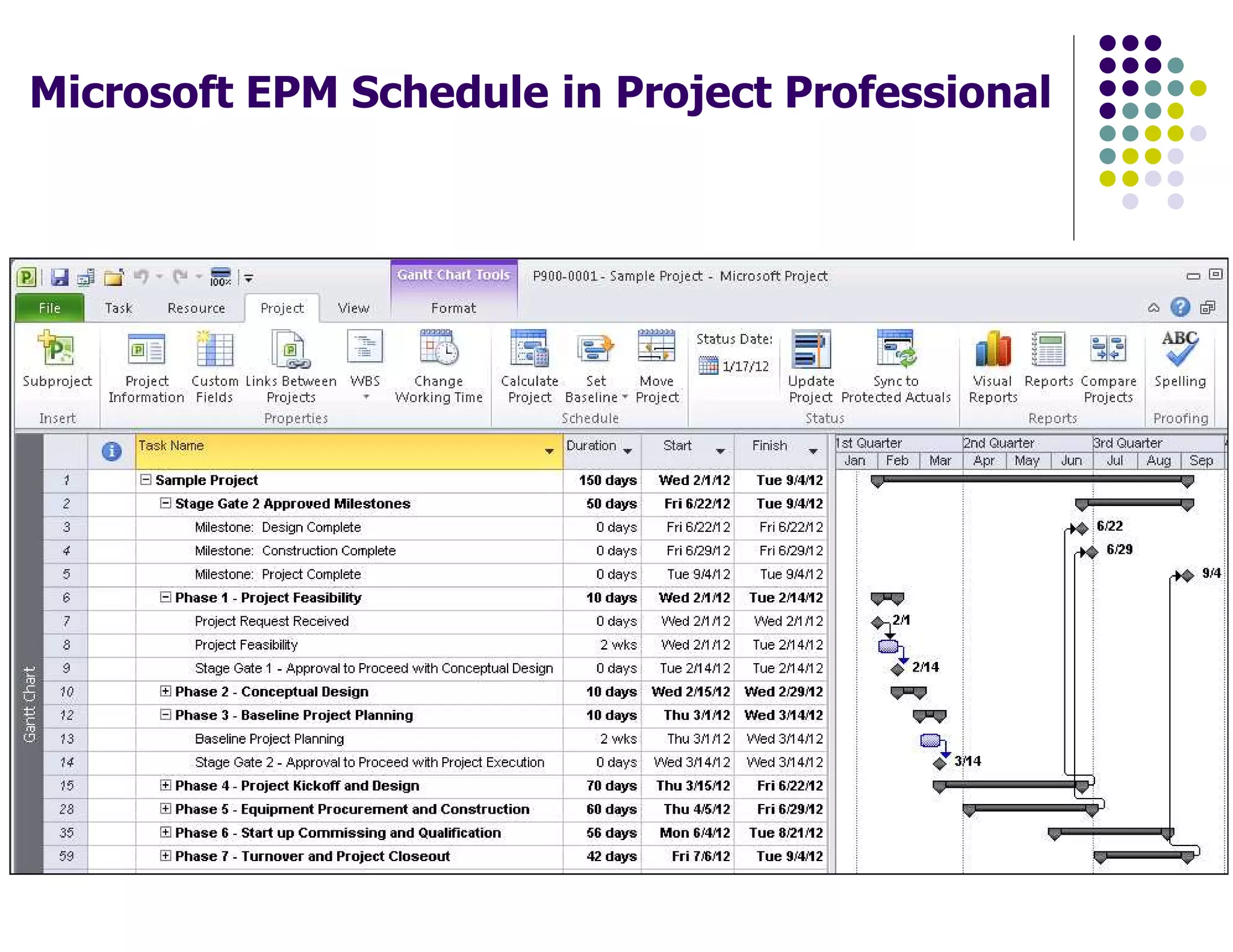

Microsoft EPM Schedule in Project Professional

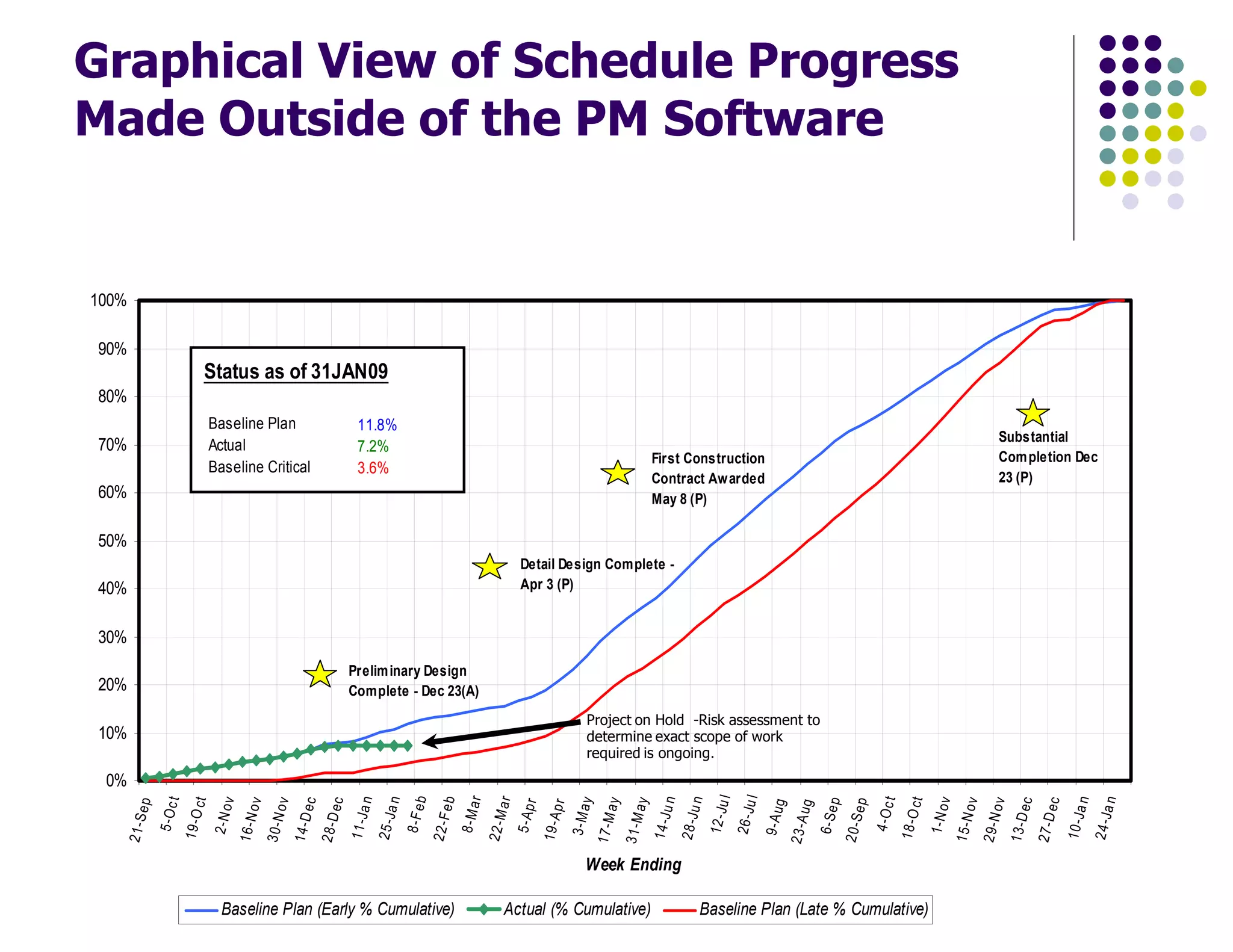

Graphical View of Schedule Progress
Made Outside of the PM Software
0%
10%
20%
30%
40%
50%
60%
70%
80%
90%
100%
21-Sep
5-Oct
19-Oct
2-Nov
16-Nov
30-Nov
14-Dec
28-Dec
11-Jan
25-Jan
8-Feb
22-Feb
8-Mar
22-Mar
5-Apr
19-Apr
3-May
17-May
31-May
14-Jun
28-Jun
12-Jul
26-Jul
9-Aug
23-Aug
6-Sep
20-Sep
4-Oct
18-Oct
1-Nov
15-Nov
29-Nov
13-Dec
27-Dec
10-Jan
24-Jan
Week Ending
Baseline Plan (Early % Cumulative) Actual (% Cumulative) Baseline Plan (Late % Cumulative)
First Construction
Contract Awarded
May 8 (P)
Detail Design Complete -
Apr 3 (P)
Substantial
Completion Dec
23 (P)
Preliminary Design
Complete - Dec 23(A)
Baseline Plan
Actual
Baseline Critical
Status as of 31JAN09
11.8%
7.2%
3.6%
Project on Hold -Risk assessment to
determine exact scope of work
required is ongoing.

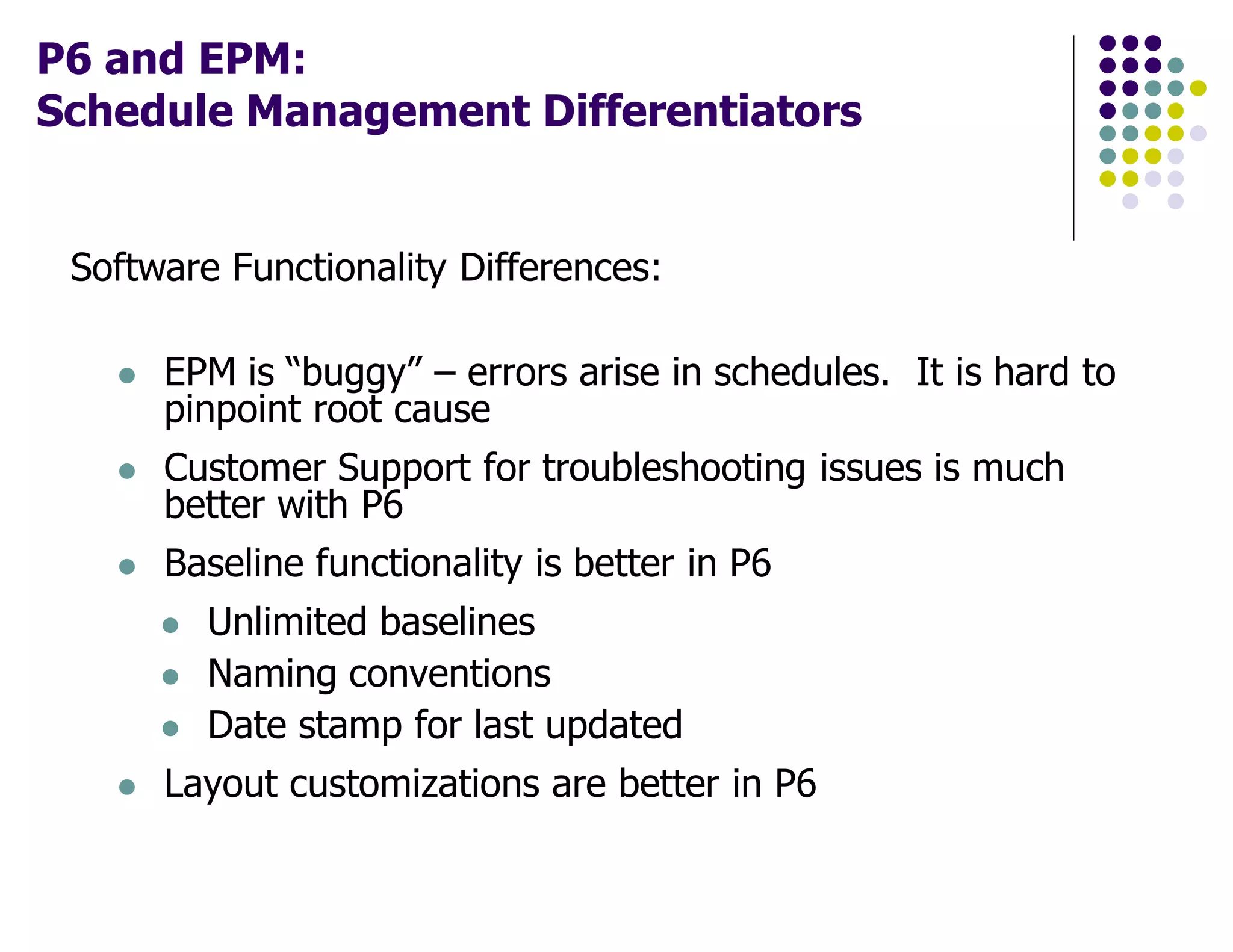

P6 and EPM:
Schedule Management Differentiators
Software Functionality Differences:
EPM is “buggy” – errors arise in schedules. It is hard to
pinpoint root cause
Customer Support for troubleshooting issues is much
better with P6
Baseline functionality is better in P6
Unlimited baselines
Naming conventions
Date stamp for last updated
Layout customizations are better in P6

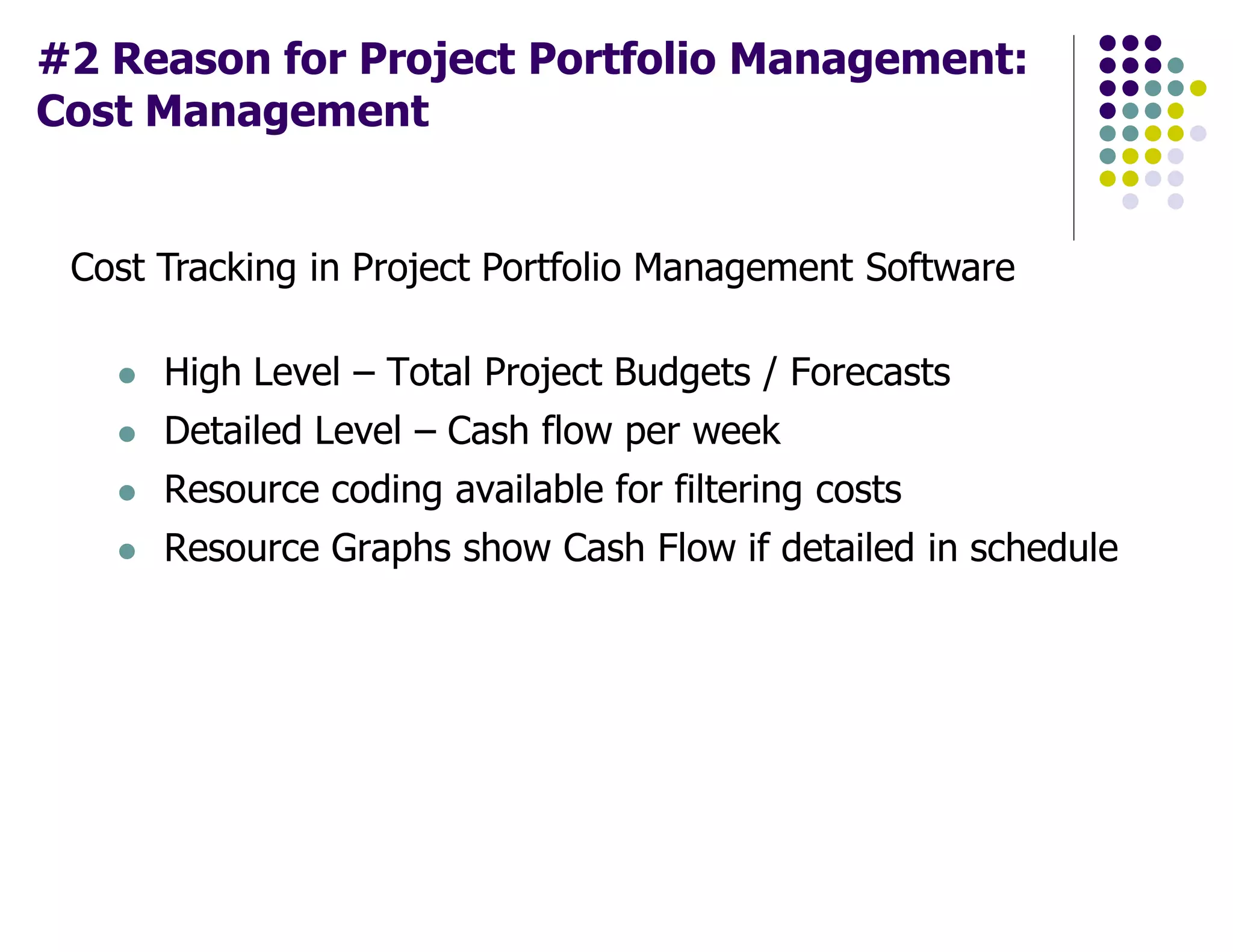

#2 Reason for Project Portfolio Management:
Cost Management
Cost Tracking in Project Portfolio Management Software
High Level – Total Project Budgets / Forecasts
Detailed Level – Cash flow per week
Resource coding available for filtering costs
Resource Graphs show Cash Flow if detailed in schedule

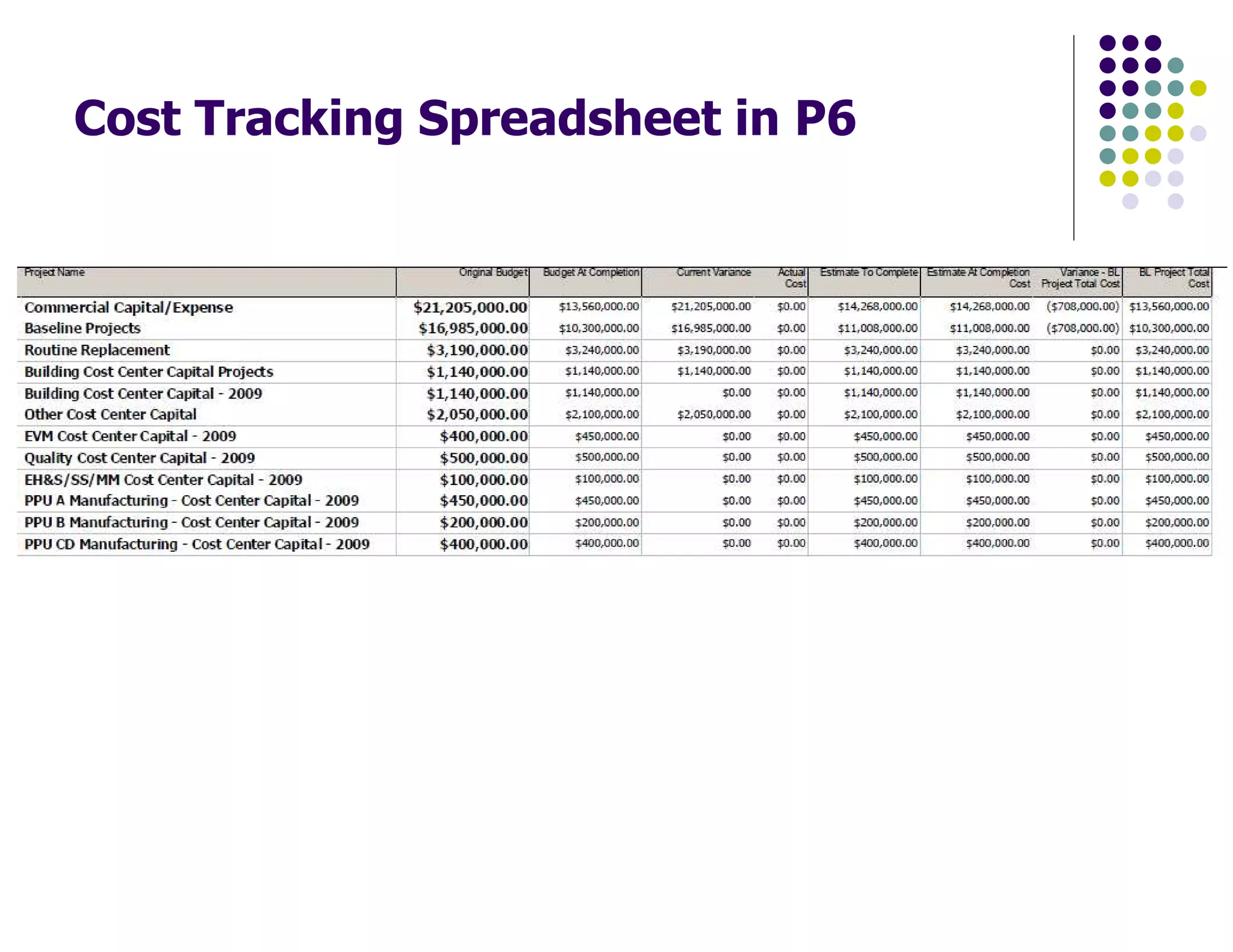

Cost Tracking Spreadsheet in P6

Cost Tracking Spreadsheet in EPM

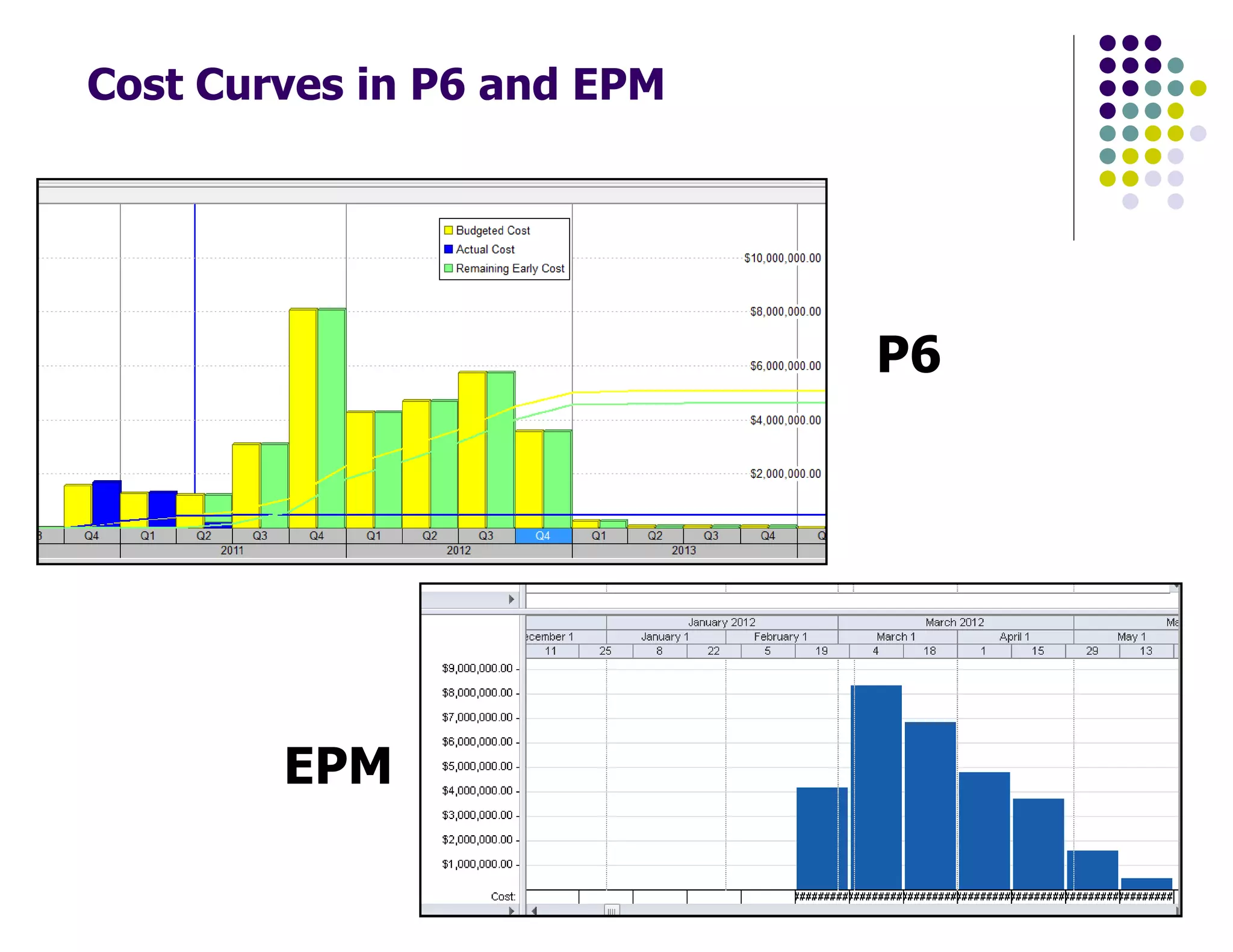

Cost Curves in P6 and EPM
P6
EPM

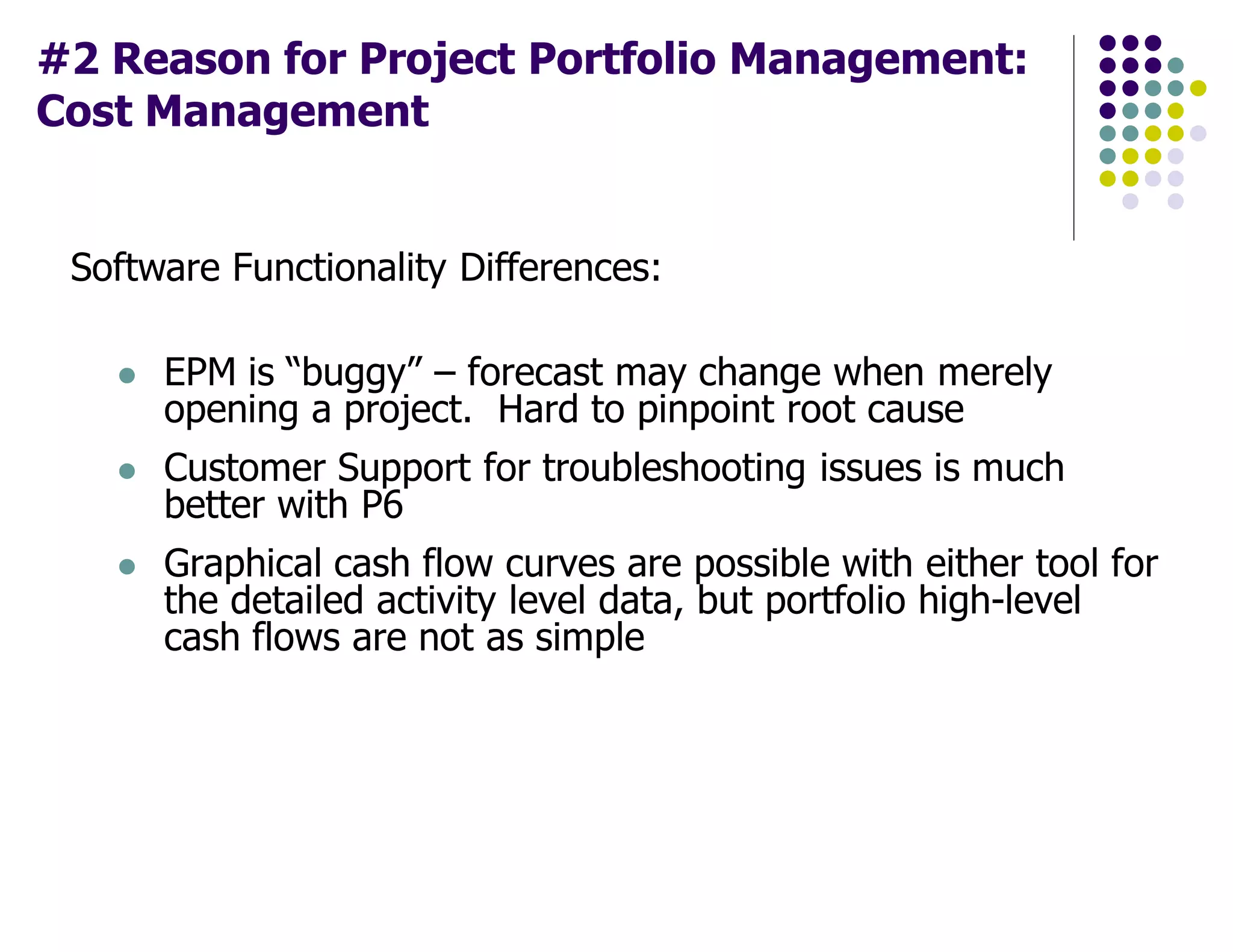

#2 Reason for Project Portfolio Management:
Cost Management
Software Functionality Differences:
EPM is “buggy” – forecast may change when merely
opening a project. Hard to pinpoint root cause
Customer Support for troubleshooting issues is much
better with P6
Graphical cash flow curves are possible with either tool for
the detailed activity level data, but portfolio high-level
cash flows are not as simple

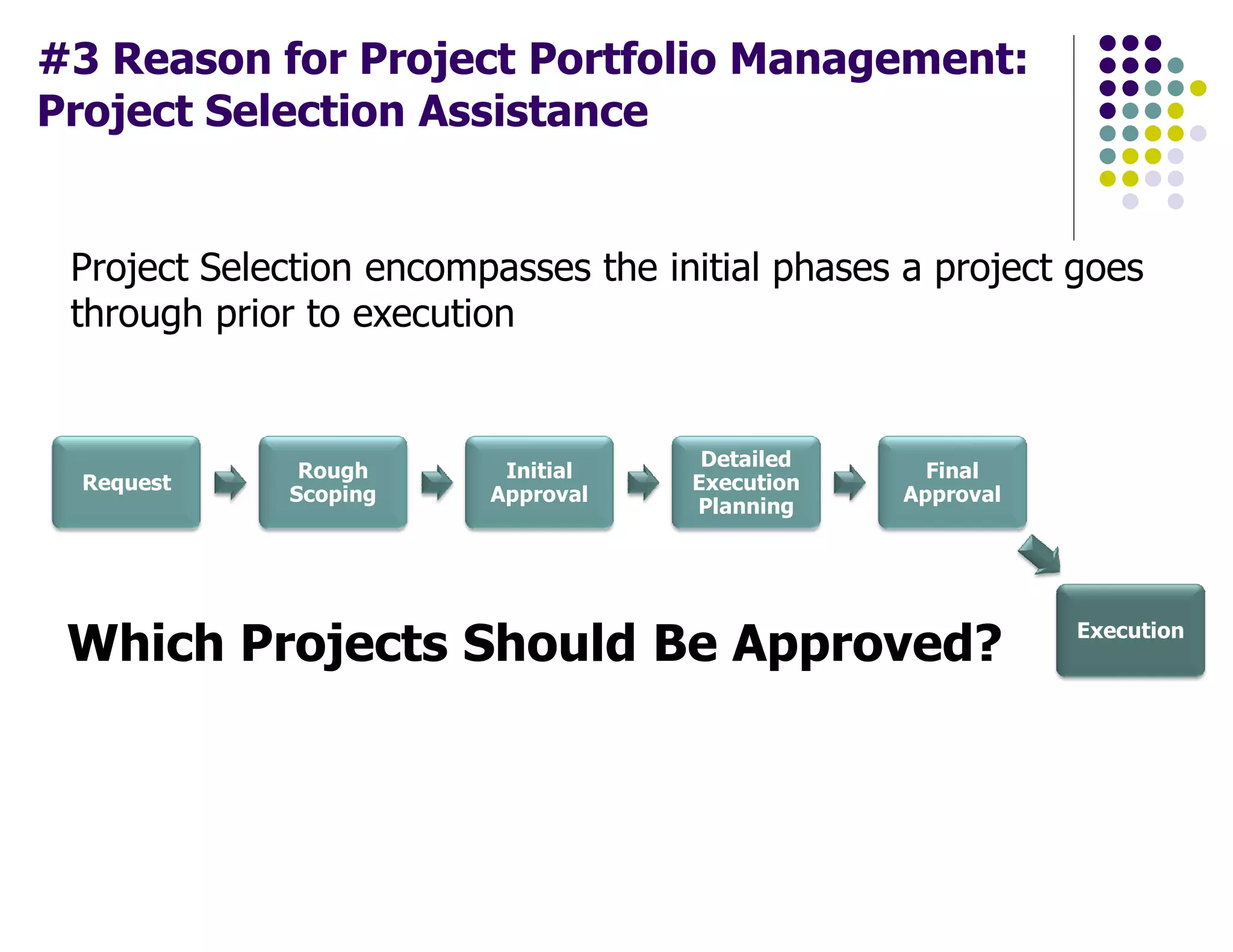

#3 Reason for Project Portfolio Management:
Project Selection Assistance
Project Selection encompasses the initial phases a project goes
through prior to execution
Request
Rough
Scoping
Initial
Approval
Detailed
Execution
Planning
Final
Approval
Execution
Which Projects Should Be Approved?

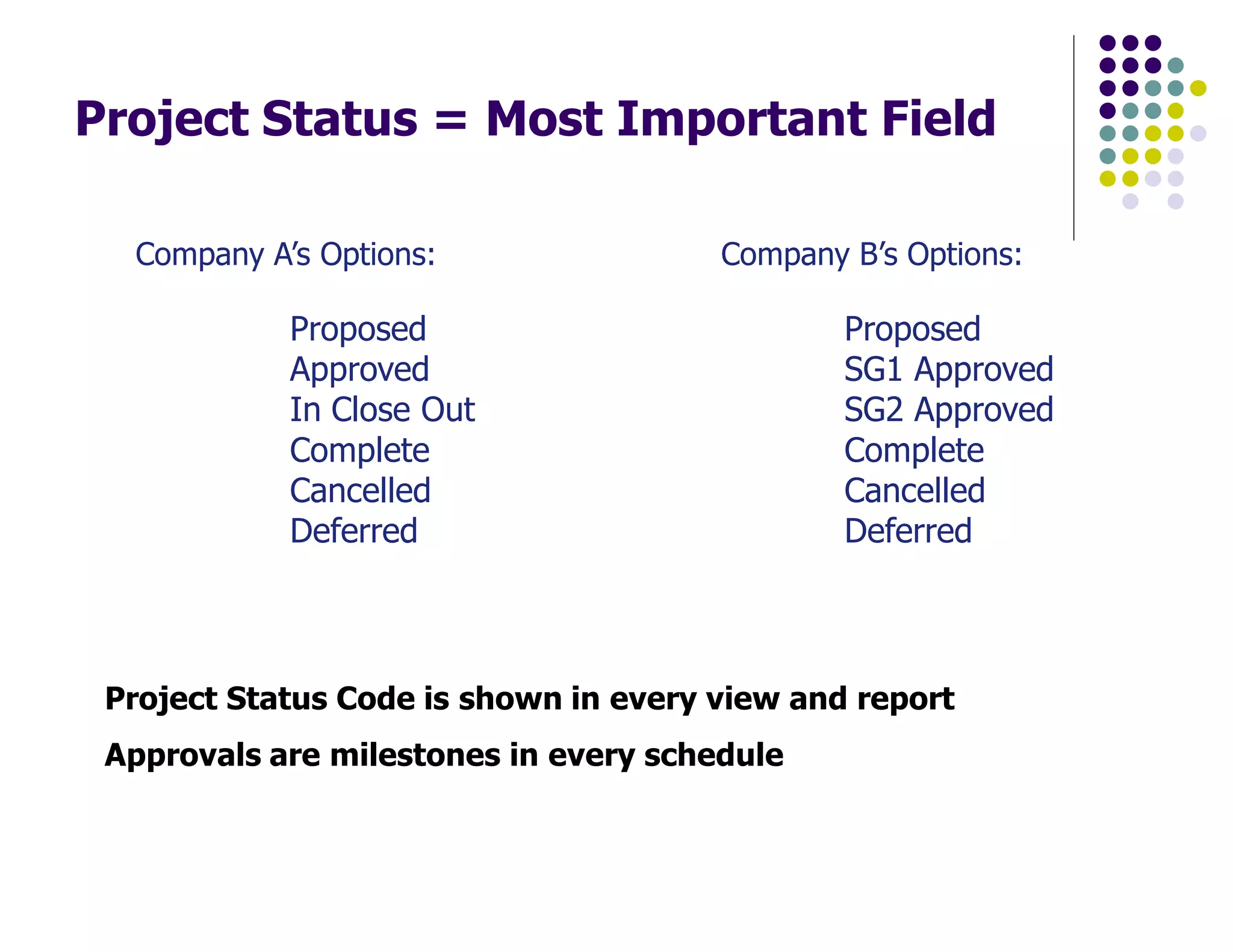

Project Status = Most Important Field
Proposed
Approved
In Close Out
Complete
Cancelled
Deferred
Proposed
SG1 Approved
SG2 Approved
Complete
Cancelled
Deferred
Company B’s Options:Company A’s Options:
Project Status Code is shown in every view and report
Approvals are milestones in every schedule

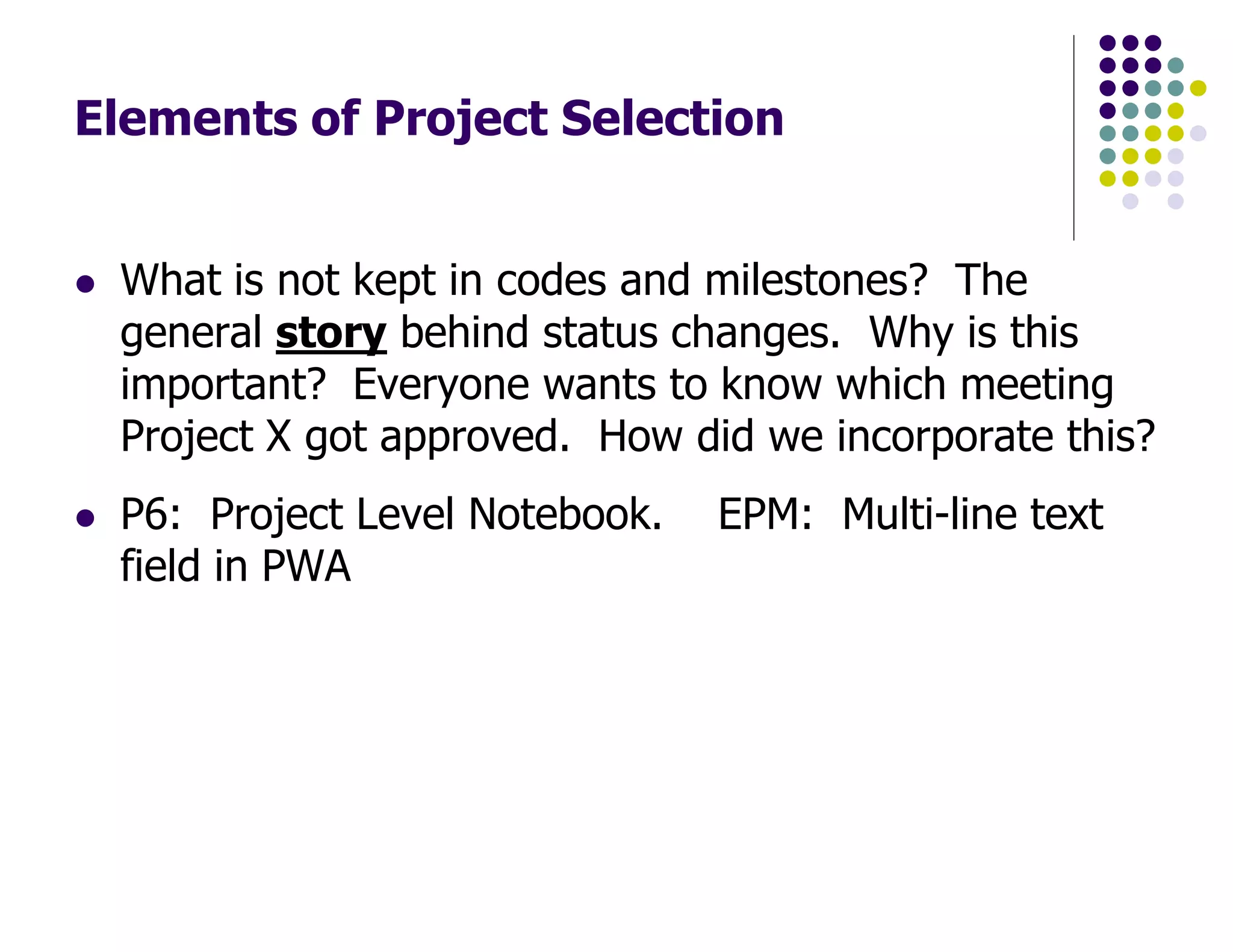

Elements of Project Selection
What is not kept in codes and milestones? The
general story behind status changes. Why is this
important? Everyone wants to know which meeting
Project X got approved. How did we incorporate this?
P6: Project Level Notebook. EPM: Multi-line text
field in PWA

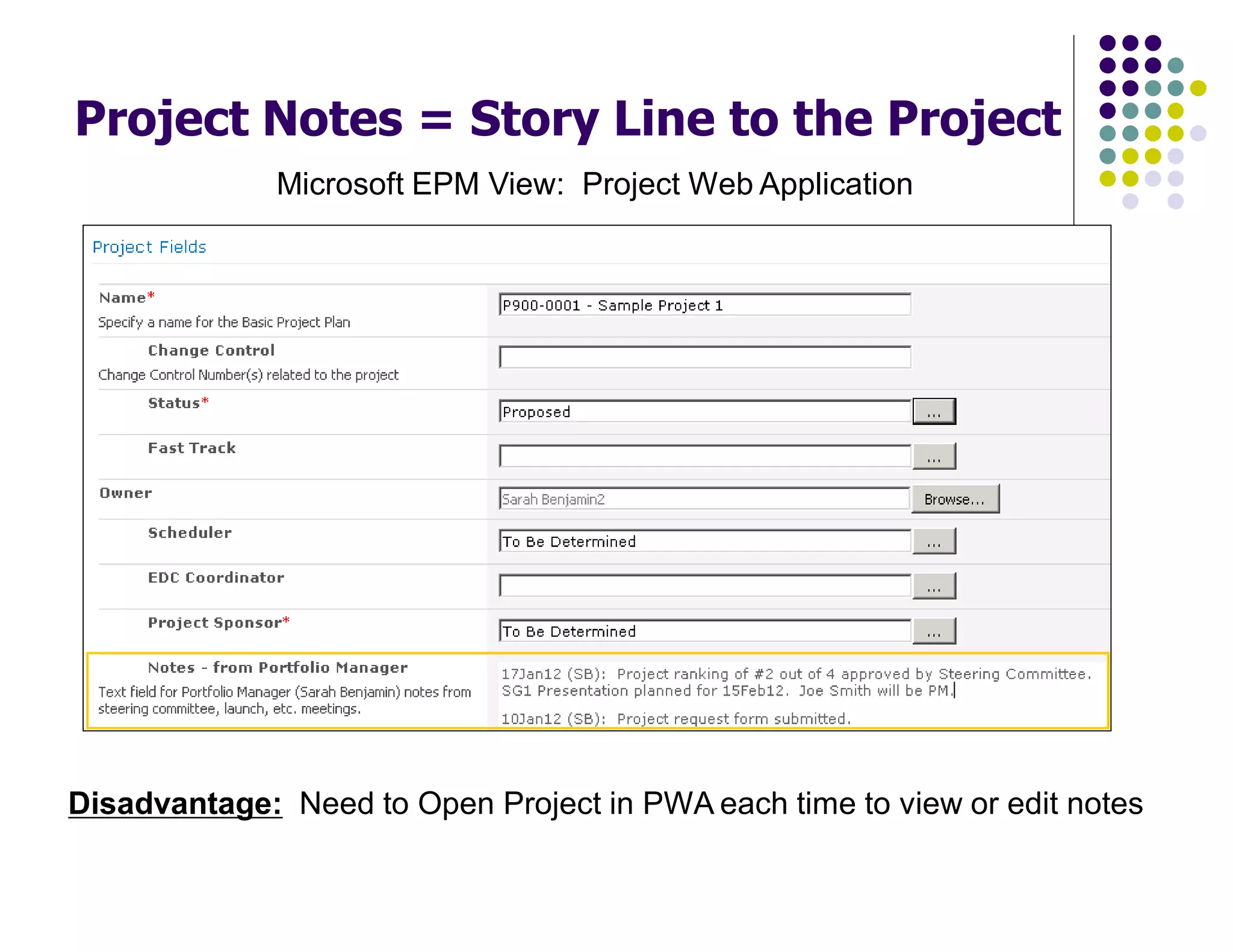

Project Notes = Story Line to the Project
Microsoft EPM View: Project Web Application
Disadvantage: Need to Open Project in PWA each time to view or edit notes

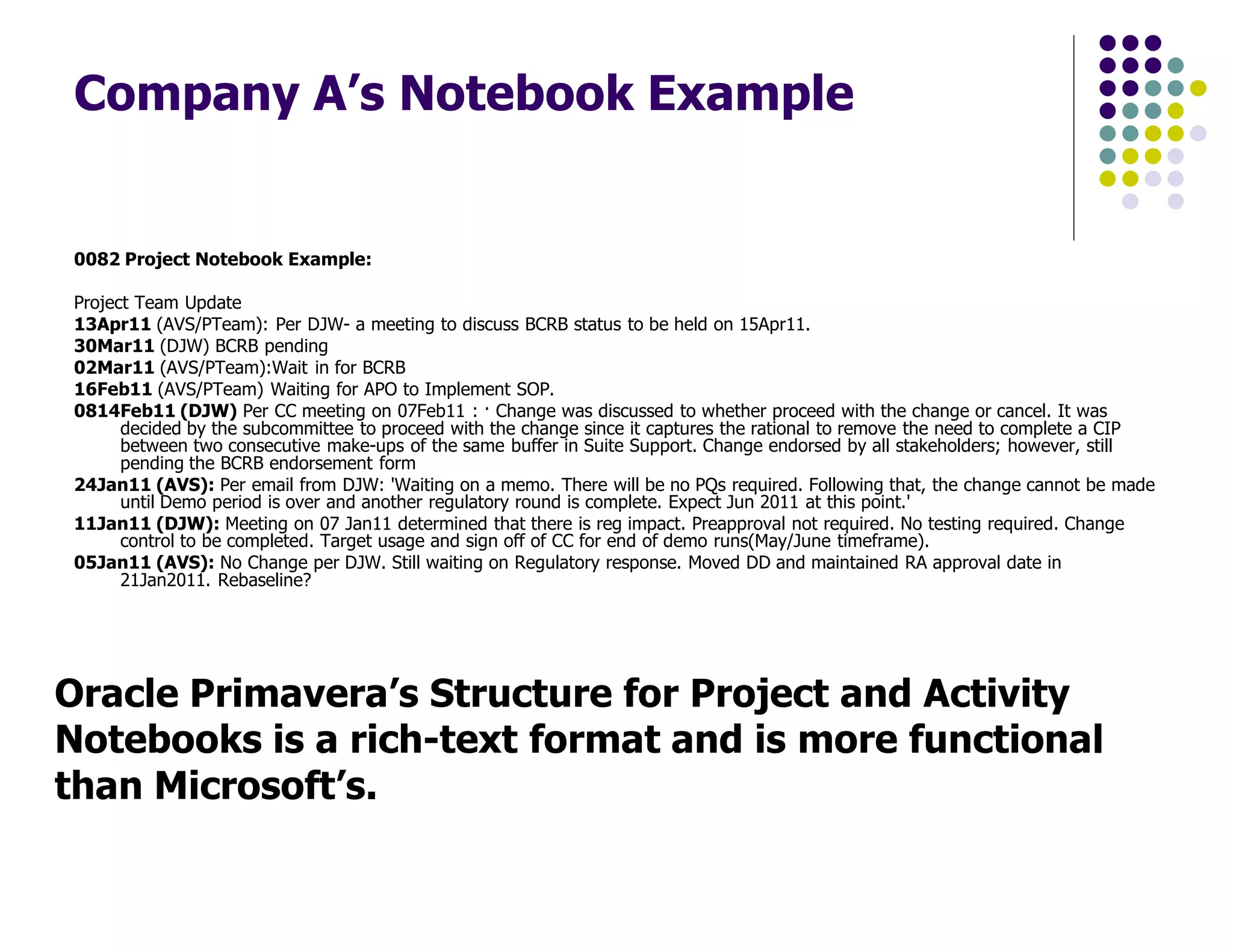

Company A’s Notebook Example
0082 Project Notebook Example:
Project Team Update
13Apr11 (AVS/PTeam): Per DJW- a meeting to discuss BCRB status to be held on 15Apr11.
30Mar11 (DJW) BCRB pending
02Mar11 (AVS/PTeam):Wait in for BCRB
16Feb11 (AVS/PTeam) Waiting for APO to Implement SOP.
0814Feb11 (DJW) Per CC meeting on 07Feb11 : · Change was discussed to whether proceed with the change or cancel. It was
decided by the subcommittee to proceed with the change since it captures the rational to remove the need to complete a CIP
between two consecutive make-ups of the same buffer in Suite Support. Change endorsed by all stakeholders; however, still
pending the BCRB endorsement form
24Jan11 (AVS): Per email from DJW: 'Waiting on a memo. There will be no PQs required. Following that, the change cannot be made
until Demo period is over and another regulatory round is complete. Expect Jun 2011 at this point.'
11Jan11 (DJW): Meeting on 07 Jan11 determined that there is reg impact. Preapproval not required. No testing required. Change
control to be completed. Target usage and sign off of CC for end of demo runs(May/June timeframe).
05Jan11 (AVS): No Change per DJW. Still waiting on Regulatory response. Moved DD and maintained RA approval date in
21Jan2011. Rebaseline?
Oracle Primavera’s Structure for Project and Activity
Notebooks is a rich-text format and is more functional
than Microsoft’s.
Microsoft Enterprise Project
Management (EPM) View of Projects
Status Indicators
Cancelled
SG2 Approved
SG1 Approved
Proposed
Problem
Caution
OK
No Info
Schedule/Cost Indicators

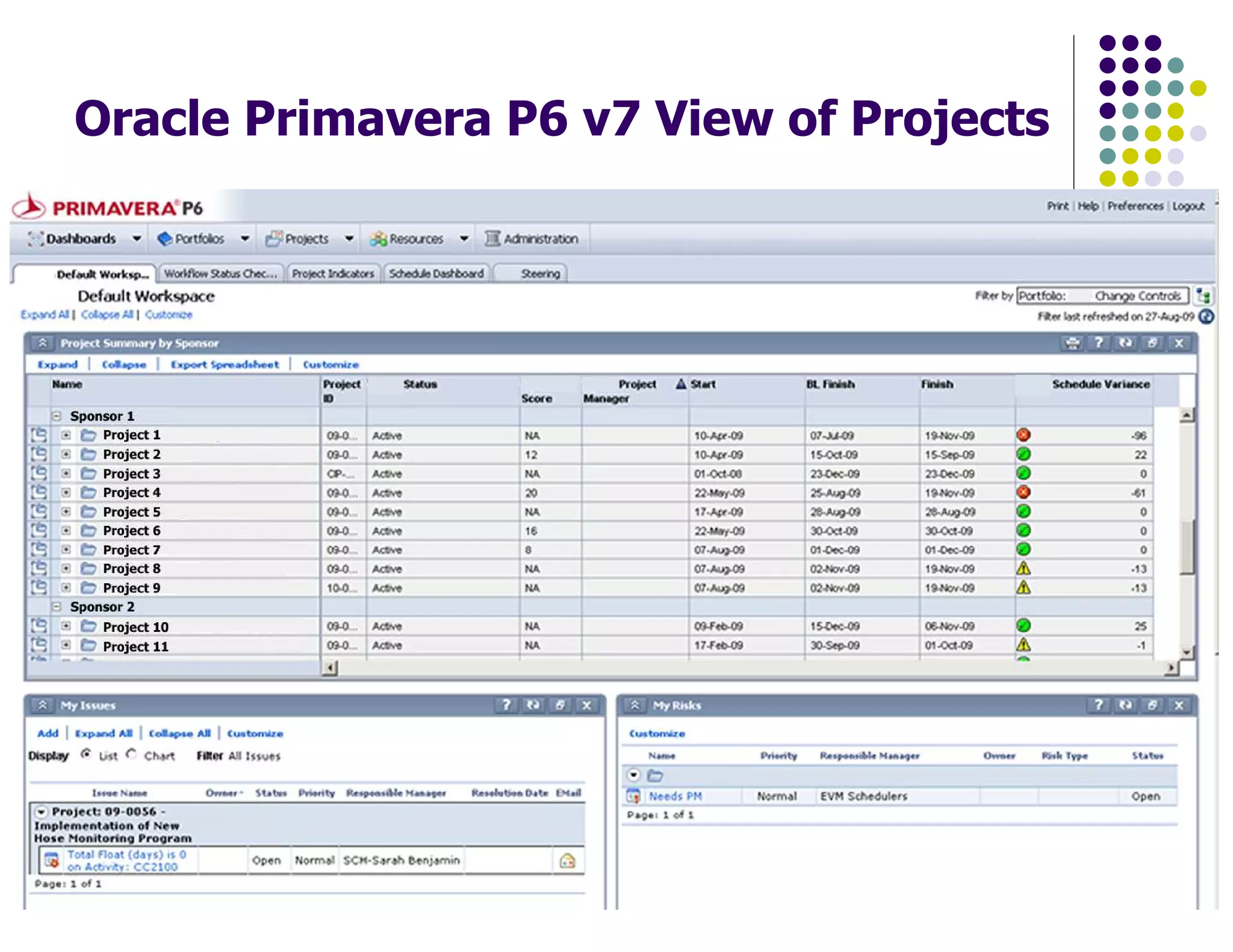

Oracle Primavera P6 v7 View of Projects

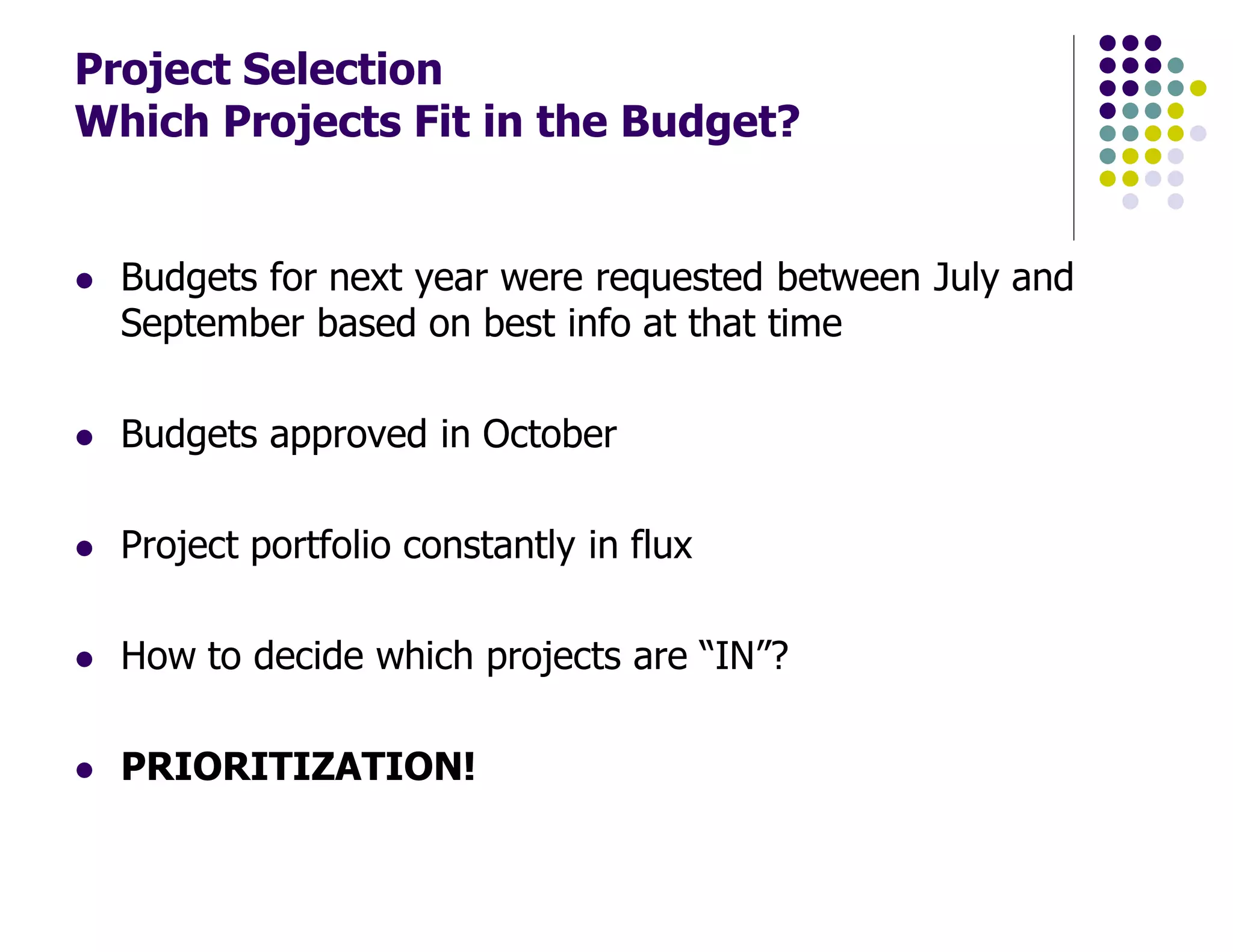

Project Selection
Which Projects Fit in the Budget?
Budgets for next year were requested between July and
September based on best info at that time
Budgets approved in October
Project portfolio constantly in flux
How to decide which projects are “IN”?
PRIORITIZATION!

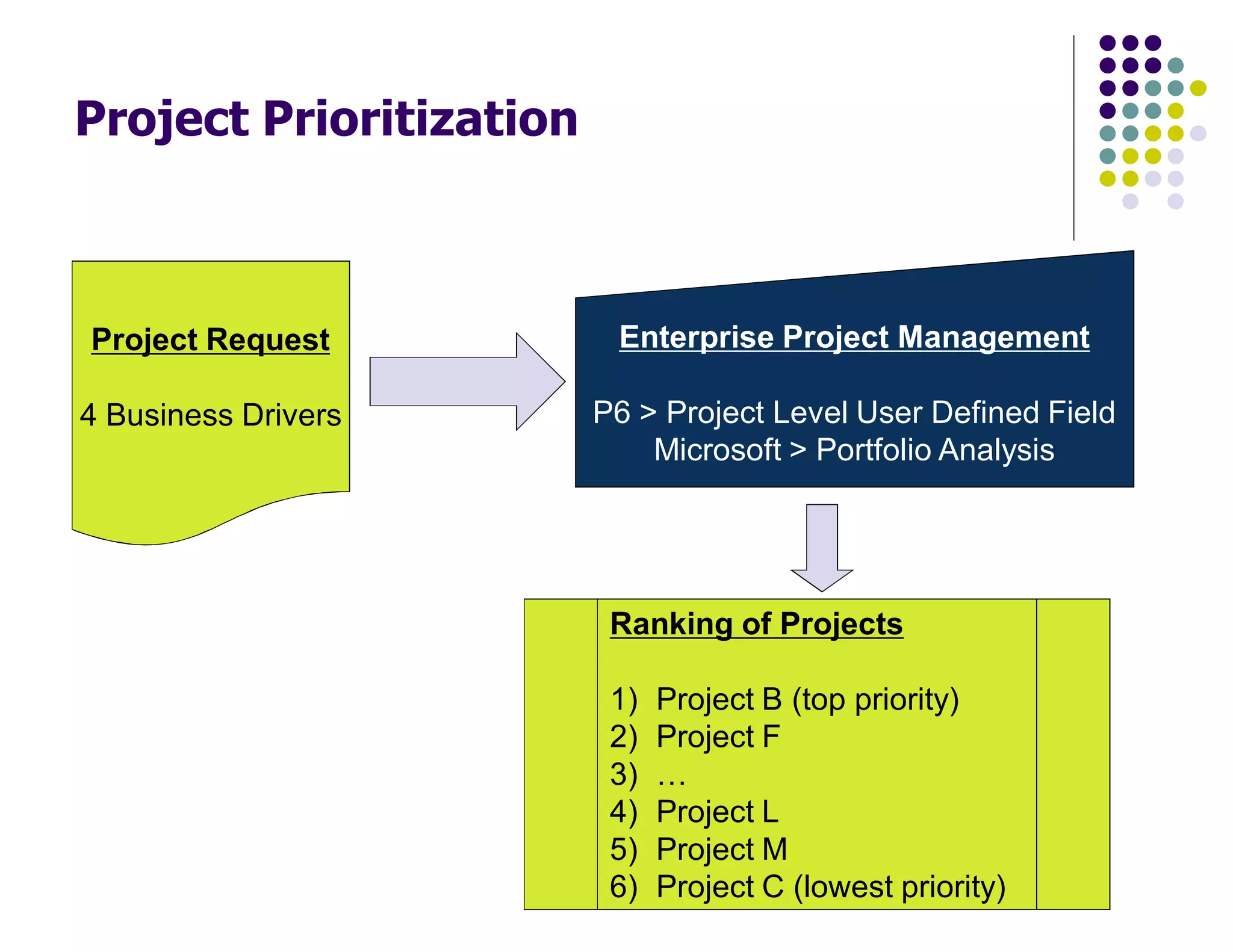

Project Prioritization
Project Request
4 Business Drivers
Enterprise Project Management
P6 > Project Level User Defined Field
Microsoft > Portfolio Analysis
Ranking of Projects
1) Project B (top priority)
2) Project F
3) …
4) Project L
5) Project M
6) Project C (lowest priority)

Company A’s Business Drivers

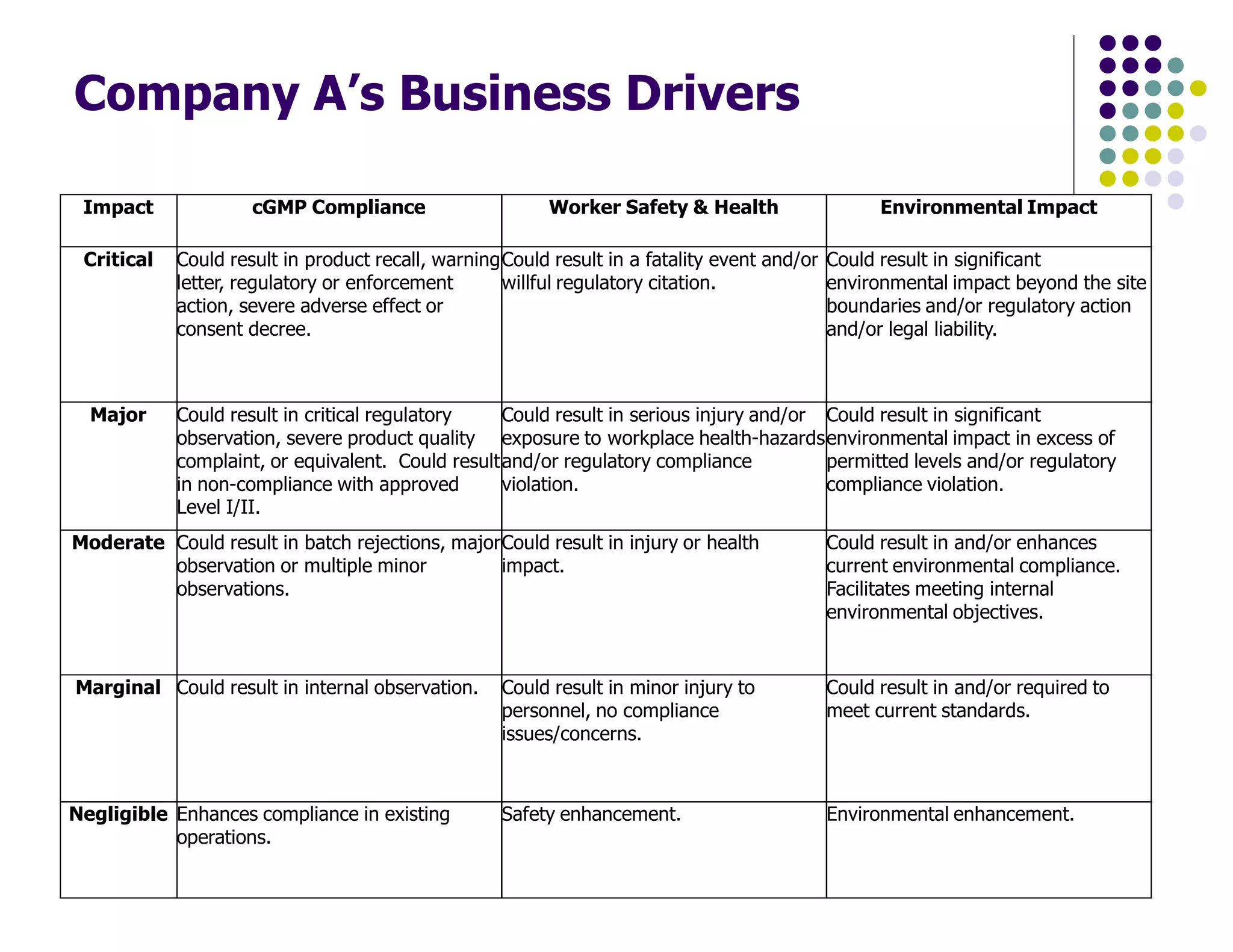

Impact cGMP Compliance Worker Safety & Health Environmental Impact
Critical Could result in product recall, warning
letter, regulatory or enforcement
action, severe adverse effect or
consent decree.
Could result in a fatality event and/or
willful regulatory citation.
Could result in significant
environmental impact beyond the site
boundaries and/or regulatory action
and/or legal liability.
Major Could result in critical regulatory
observation, severe product quality
complaint, or equivalent. Could result
in non-compliance with approved
Level I/II.
Could result in serious injury and/or
exposure to workplace health-hazards
and/or regulatory compliance
violation.
Could result in significant
environmental impact in excess of
permitted levels and/or regulatory
compliance violation.
Moderate Could result in batch rejections, major
observation or multiple minor
observations.
Could result in injury or health
impact.
Could result in and/or enhances
current environmental compliance.
Facilitates meeting internal
environmental objectives.
Marginal Could result in internal observation. Could result in minor injury to
personnel, no compliance
issues/concerns.
Could result in and/or required to
meet current standards.
Negligible Enhances compliance in existing
operations.
Safety enhancement. Environmental enhancement.
Scoring Behind the Project Request to
Calculate Project Score
Company A’s Excel-Based Project Request
Form Showing Project Business Driver
Company A’s Oracle Primavera P6
Web Portfolio View – Graphical Output
Company B’s Business Drivers
Compliance Need
Operational Need
Capability Improvement
Unit Cost Improvement
These were ranked 0, 1, 2, or 3 based on strength and
urgency. Compliance and Operational need were
weighted higher than Capability and Unit Cost.
Microsoft Enterprise Project Management (EPM) produced a “pair-
wise” comparison of projects and ranked them in order of priority
Leadership teams judged the prioritization output and made
adjustments to keep business drivers application consistent

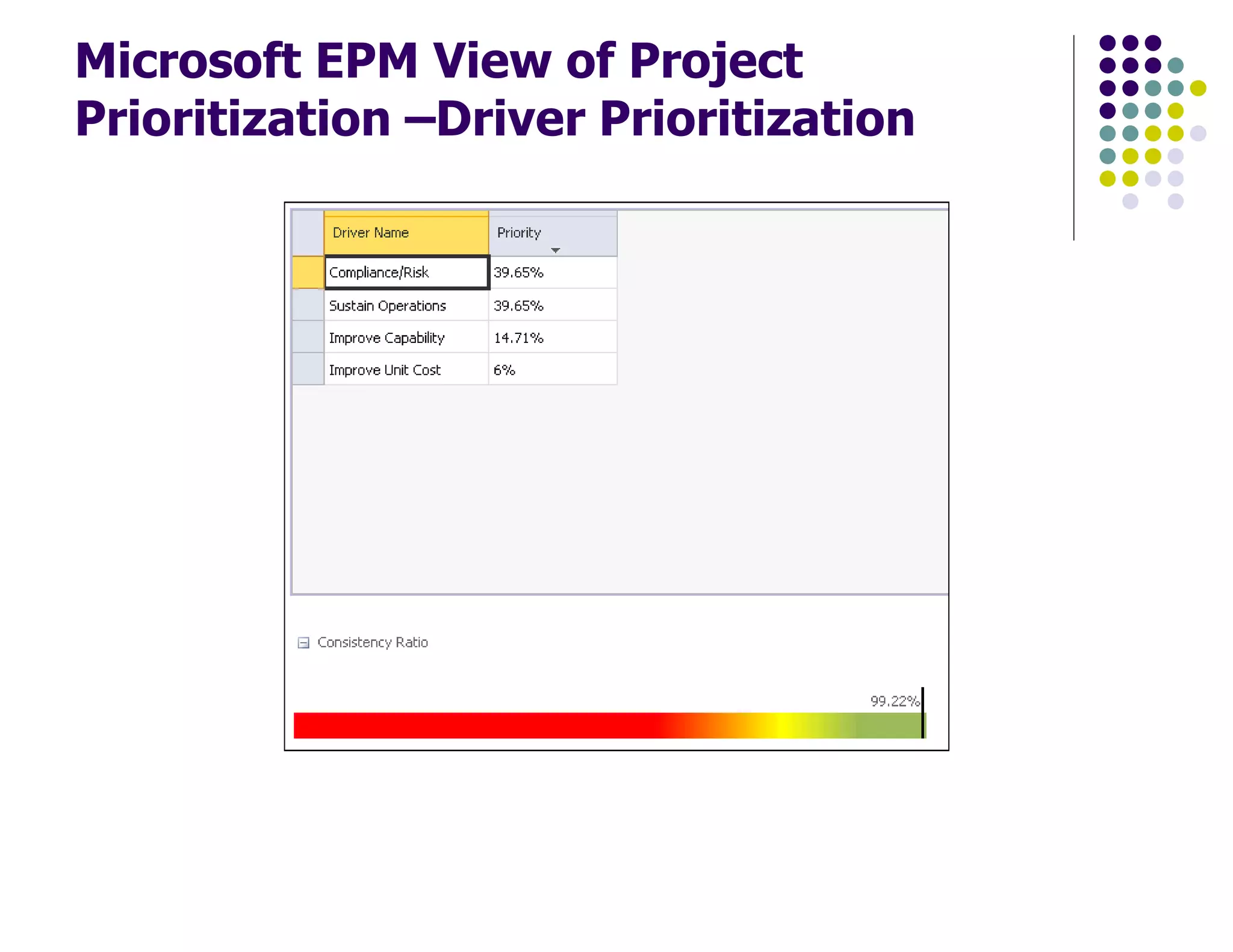

Microsoft EPM View of Project
Prioritization –Driver Prioritization

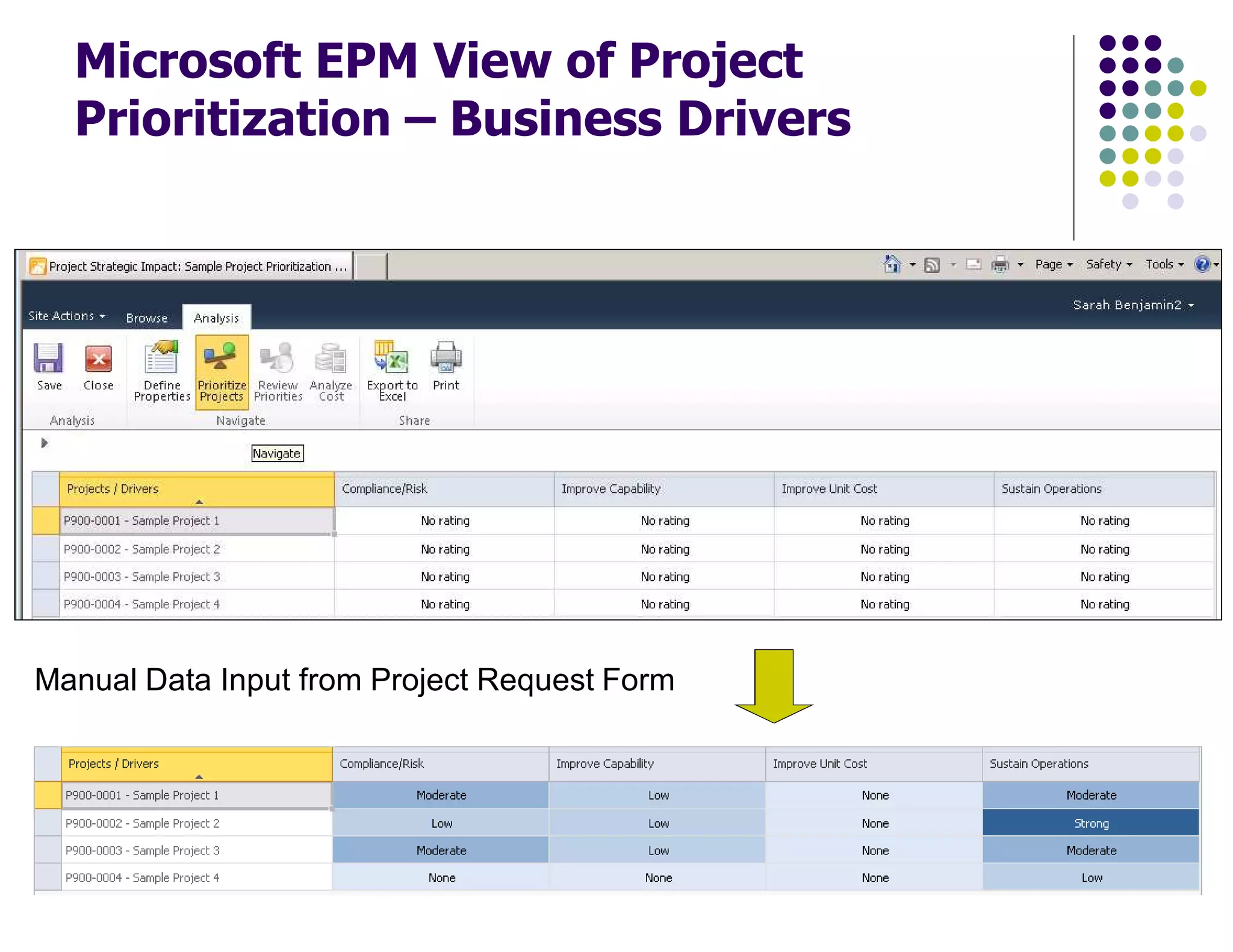

Microsoft EPM View of Project
Prioritization – Business Drivers
Manual Data Input from Project Request Form

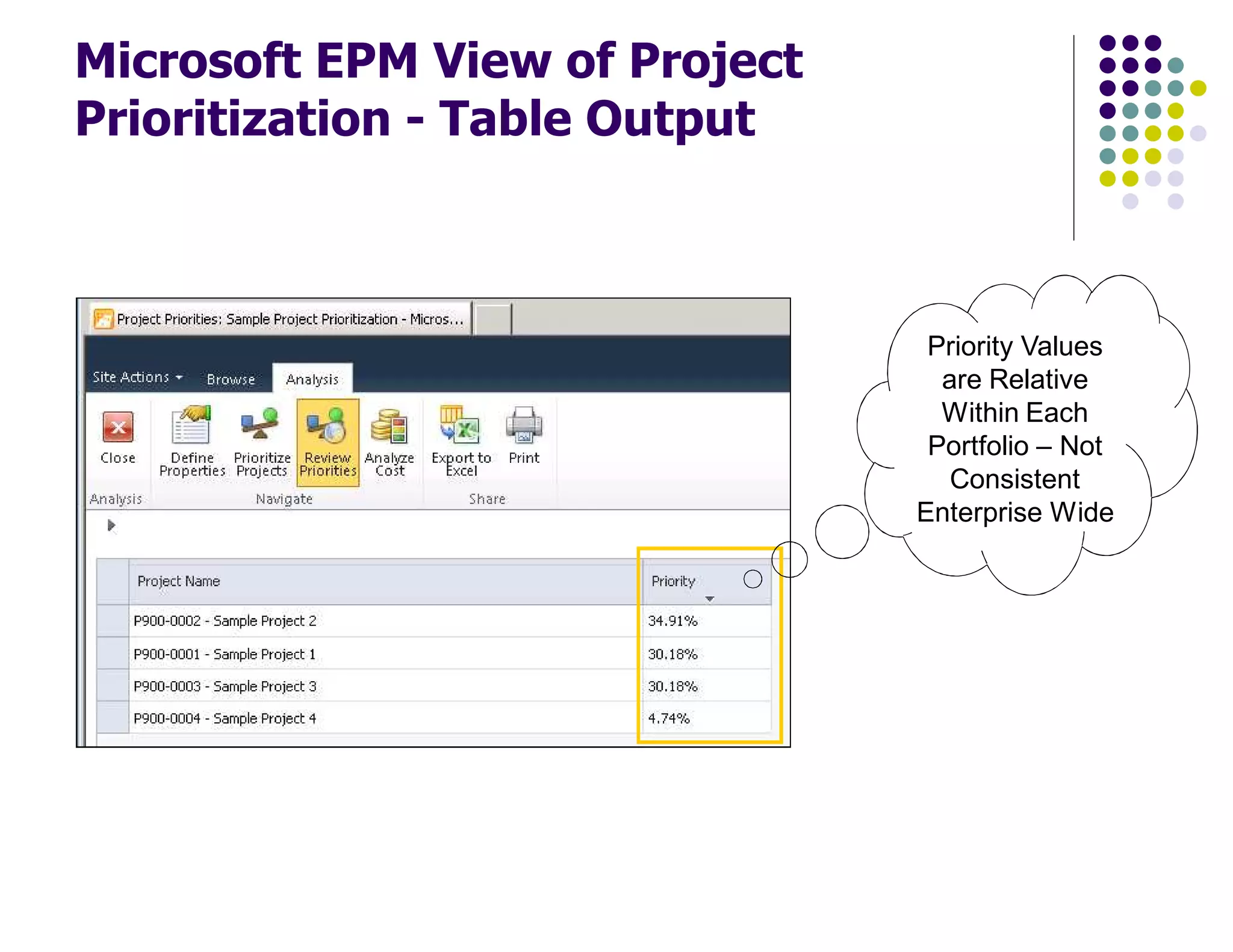

Microsoft EPM View of Project
Prioritization - Table Output
Priority Values
are Relative
Within Each
Portfolio – Not
Consistent
Enterprise Wide
Company B’s Microsoft EPM View of
Project Prioritization – Graphical Output
Company B’s Microsoft Excel View of
Project Prioritization – Export
Advantage: These weekly Excel spreadsheets were easy to distribute, modify
and filter
Disadvantage: EPM does not export Business Driver data in the same file so
two exports had to be merged prior to each distribution, not able to include
prioritization on standard reports
Company A’s Portfolio Report
Generated by Oracle Primavera P6
The Project Score is a Project Code that is easily
included on any view or report
Project Prioritization - Commonalities
Both Companies:
Weekly Review of Priorities by Leadership Team
Management Stood Behind Focus on Business Drivers
Final Score / Ranking Drove Project Prioritization
Prioritization Drove Resource Assignments
Forcing In Allowed, but Not Commonly Utilized
Systems Do Not Track Changes to Drivers
Prioritization Drove Inclusion in Overall Portfolio Budget
Project Prioritization - Differences
Software Generation of Prioritization:
P6 Uses Standard Mathematical Formula
Projects Easily Ranked Against Each Other
Example: Score 14 vs. Score 12
Score is an Enterprise-wide Project Code
Microsoft Uses Pair wise Comparison
Projects Ranked within Portfolios and Score Not Easily Transferable
Absolute Value of Project’s Priority Difficult to Calculate
Rankings Kept in Separate Module of EPM, Not Project Code

Project Prioritization:
Theoretical vs. Practical
Both P6 and EPM use a calculation of business drivers to score
projects
Theoretically there are many more attributes related to whether or
not the project should be approved
There is considerable maturity still left to be gained at pharmaceutical
companies in regards to project selection
Net Present Value and Return on Investment are not factored in
Overall financial implications of doing projects versus not doing them
need to be better modeled to produce overall Value to the company
Better modeling requires more time spent on scoping the projects

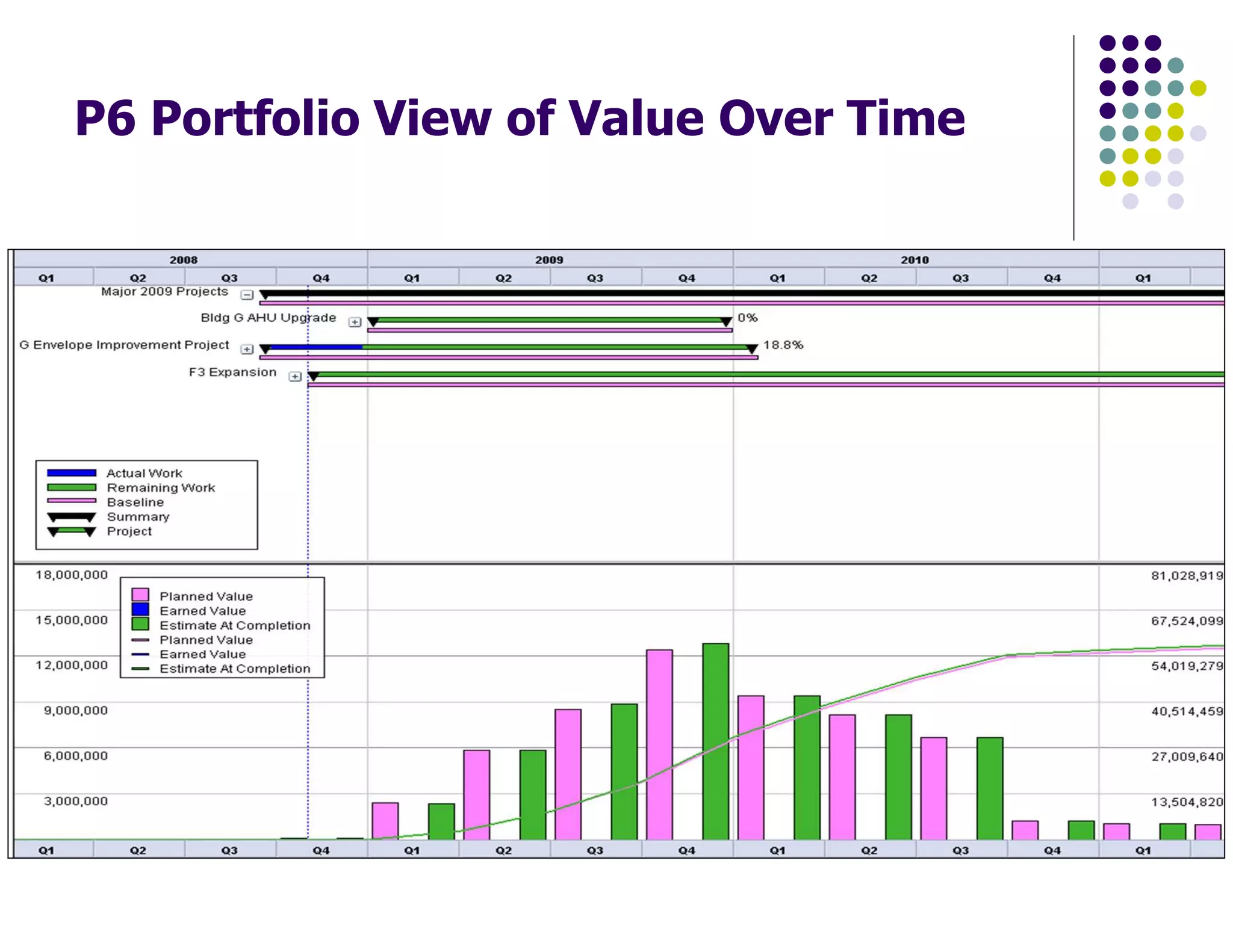

P6 Portfolio View of Value Over Time

Resource Forecasting
High Level Resource Estimating – Immature Process
Ballpark Total Hours Provided by Each Department
Estimates Not Input into EPM or P6
Estimates Used for Approval Decision
Company A Tried Implementing a Separate Resource
Management Tool, no integration to project schedules
Company B did not have a mechanism for calculating total
resource forecasts across the portfolio
Resource Forecasting = Political Black Hole

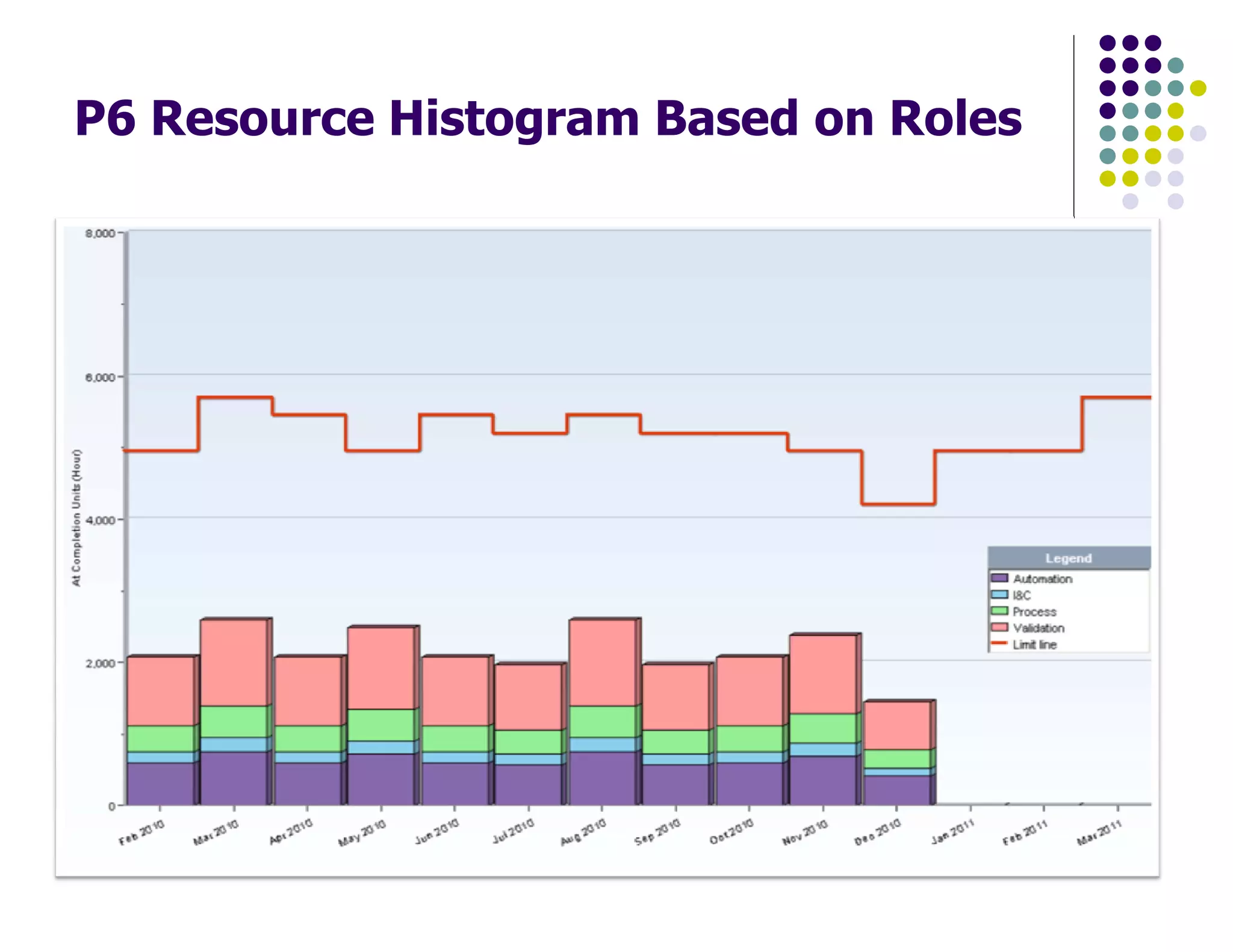

P6 Resource Histogram Based on Roles
Microsoft EPM or Oracle Primavera P6?
Strengths to Either System:
One Single Source of Project Information
Schedule Maintenance and Automatic Roll Up / Reporting
The Ability for Future Maturity:
Improved Portfolio Management
Cost Forecasting / Tracking
Resource Forecasting / Tracking
Flexibility of Reporting for Varied Audiences
Business Intelligence Data Mining
Microsoft EPM or Oracle Primavera P6?

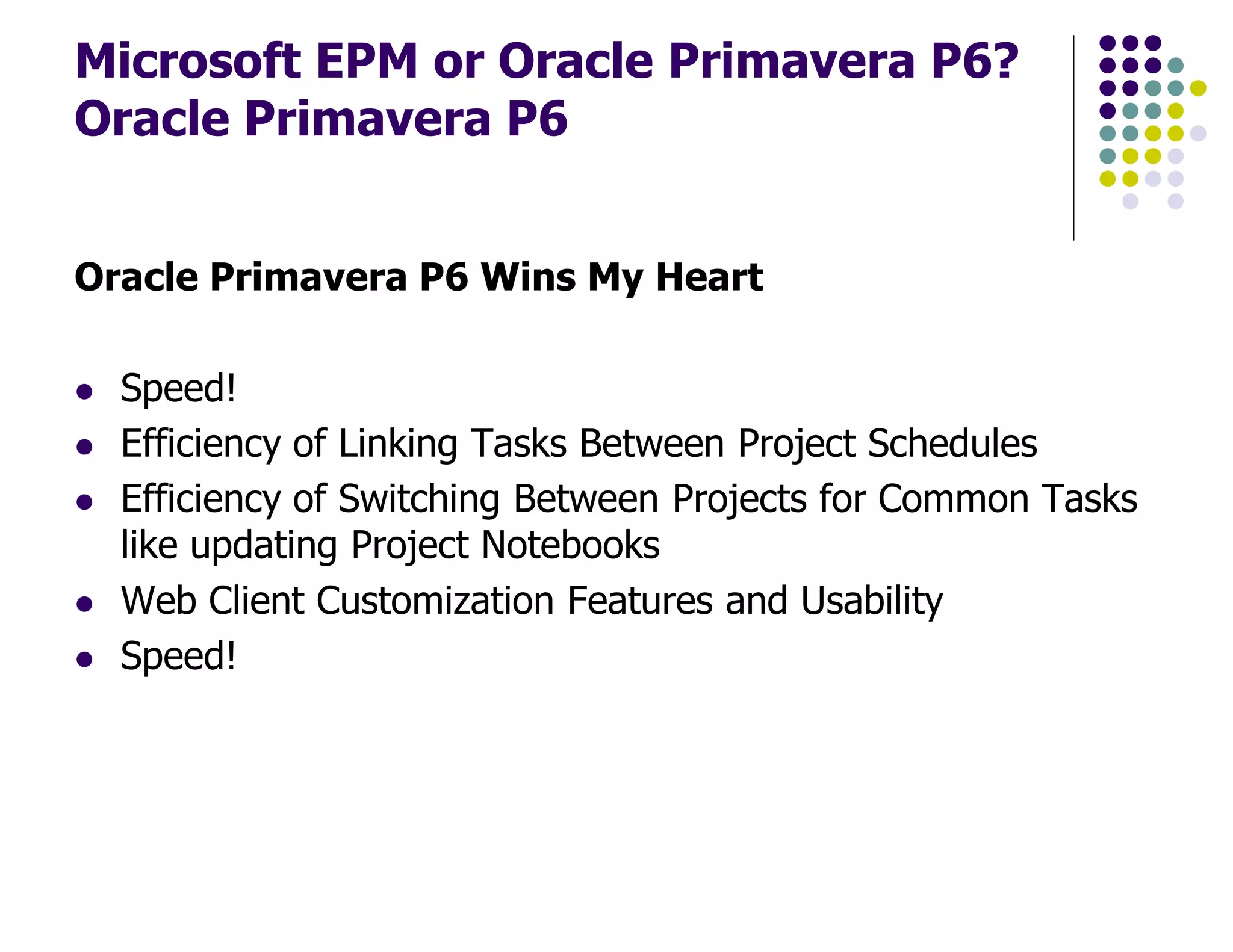

Oracle Primavera P6
Oracle Primavera P6 Wins My Heart
Speed!
Efficiency of Linking Tasks Between Project Schedules
Efficiency of Switching Between Projects for Common Tasks
like updating Project Notebooks
Web Client Customization Features and Usability
Speed!
Why Did Company A Choose Primavera vs.
Other Portfolio Management Tools?
Centralized Database (no file revisions)
Accessible via web portal – included with licenses
Future Integration Capabilities with SAP and/or Process Scheduling
Software
Email Notifications about Issues
WBS Standardization
In-House Expertise – Site has utilized Primavera for 10+ years

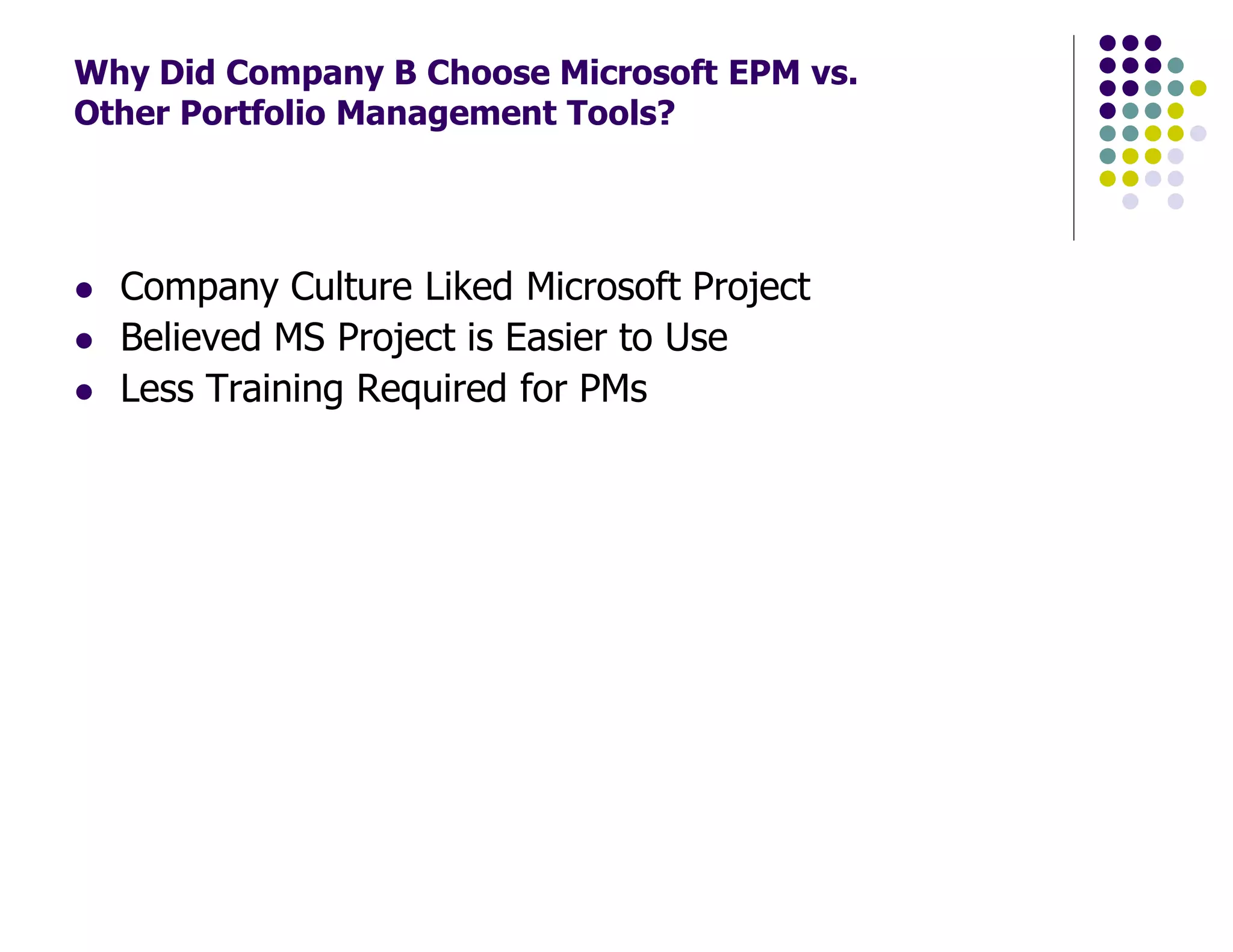

Why Did Company B Choose Microsoft EPM vs.
Other Portfolio Management Tools?
Company Culture Liked Microsoft Project
Believed MS Project is Easier to Use
Less Training Required for PMs
Based on the robust capabilities of the Oracle Primavera P6
solution compared to the relatively less mature Microsoft
Enterprise Project Management, the preference for a company
with no other influences should be to
Use Oracle Primavera P6.
Certain company cultures may already be entrenched in
Microsoft technologies and may shy away from supporting a
major Oracle-based solution due to corporate standards. This
would need to be weighed with the long term commitment that
will be made to the project management solution and the
various headaches that will need to be overcome by the
project management departmental software users and
administrators.
Microsoft EPM or Oracle Primavera P6?
CONCLUSION
Extra Slides for Reference
The following slides are included for reference purposes
References
GMP
http://en.wikipedia.org/wiki/Good_manufacturing_practice
Oracle Primavera
http://www.oracle.com/us/products/applications/primavera
Microsoft Enterprise Project Management
http://www.microsoft.com/project/en-us/solutions.aspx
Project Server 2010: A financial management solution for projects, programs and portfolios
(white paper)
http://go.microsoft.com/fwlink/p/?LinkId=216201
Portfolio strategy with Project Server 2010 (white paper)
http://go.microsoft.com/fwlink/p/?LinkId=194203
Thank You
Thanks for listening to my story.
Feel free to contact me with questions or comments.
Email: sbenjamin@tauruspcc.com
Linked In: http://www.linkedin.com/in/sarahbenjamin

Project portfolio management comparison of microsoft epm and primavera p6 v7 ppt (1)

  • 1.
    Pharmaceutical Project PortfolioManagement Comparison of Microsoft EPM vs. Primavera P6 v7 Sarah Benjamin Taurus Project Controls April 2012
  • 2.
    The Agenda Speaker Types ofProjects Transition from Manual Tracking into Enterprise Tool Dimensions Project Prioritization Budget Management for the Portfolio Resource Management
  • 3.
    Speaker Sarah Benjamin Project Scheduler PrimaveraP6 v7 Web Lead Project Portfolio Manager Consultant Email: sbenjamin@tauruspcc.com Linked In: http://www.linkedin.com/in/sarahbenjamin
  • 4.
    Who We Are TaurusProject Controls Consulting firm formed in 2011 Interactive Planners Schedulers Portfolio Managers Cost Engineers
  • 5.
    Why Use ProjectPortfolio Management Enhancement of the project by project scheduling system Central system for project status that allows one-stop shopping for answers to “Where Are We Right Now?” “Where Are We Going?” “What Are We Doing Next Year?” “What Issues and Risks Are Affecting Projects?” Site-wide project prioritization based on business drivers Internal resources need visibility of workload and site priorities Flexible Cost Forecasting and Reporting
  • 6.
    Types of BiotechProjects Projects within the scope of Project Controls for each facility are typically capital improvements Good Manufacturing Practices (GMP) Change Control / Regulatory Approvals Impact Assessments Implementation Plans, Test Plans, Validation Reports Example Projects: Changes to Process Equipment to accommodate new products Valve Replacements Tank Repairs Utility System Maintenance Automation Improvements
  • 7.
    Types of Datain the PM System Project Business Drivers and Priority Schedule Tracking High Level Cost Forecasting Project Notes Types of Data Not in the PM System • Transactional Cost Tracking • Resource Tracking for All Projects
  • 8.
    Situational Comparison ofMicrosoft EPM vs. Primavera P6 v7 This is a situation comparison of two biotech companies based on my personal experience over the last 4 years Both companies are large corporate biotech manufacturers Company A is bigger and more mature Company B is not quite as big and has not been manufacturing products as long as Company A This is NOT a feature to feature checklist of all possible software functionality in the two systems
  • 9.
    Transition from ManualTracking into Enterprise Tool Excel was the tool of choice for both biotech companies before Enterprise Project Management was implemented Excel Advantages: Quick updates Notes & Comments could be added anywhere Portable – easy to attach and share Excel Challenges: Version Control Changes by many users were not tracked Project marked complete – who said it’s done? Schedule Information Not Driven by Actual Schedules (outdated)
  • 10.
    Excel Project List– The Manual Method Disadvantages: No single version of the Truth. Missing Important Data like Phase, PMs, Dates, Budgets, Sponsors Schedule Dates Not Driven By Actual Schedules And Often Outdated
  • 11.
    Enterprise System Architecture Differences CompanyA’s Primavera System Maintained In-House Speed of System = Fast Cost per Year < $50k Speed of System via VPN = Medium Maintenance/Updates = Slow IT Support = Slow Data Loss / Backups = Challenging due to DB restoration process Reporting Capabilities = Accessible, customizable, non-graphical Company B’s Microsoft EPM System Hosted Remotely Speed of System = Slow Cost per Year > $100k Speed of System via VPN = Slow (but VPN not required) Maintenance/Updates = Fast IT Support = Medium Data Loss / Backups = Manageable due to Automatic Archive DB Reporting Capabilities = Challenging, OLAP cubes may need consultant support, graphical
  • 12.
    Company A Oracle PrimaveraP6 Web Portfolio Gantt P6 provides more options for Multi-Project Gantt view like showing milestones for each project.
  • 13.
    Company B Microsoft EPMWeb Portfolio Gantt Microsoft EPM has a standard Portfolio level Gantt chart view that shows one bar per project.
  • 14.
    #1 Reason forProject Portfolio Management: Schedule Management Centralizing All Project Schedules is the #1 Reason PPM Systems are Implemented Schedules can have inter-project links Schedules are more visible to all users of the software Schedule updating is more visible to managers Schedule reporting is simplified
  • 15.
    P6 and EPMare Both Robust Schedule Management Systems Schedule Management Features Used by Companies A & B: Inter-project links / logic between activities Standardized schedule views – output to PDF Schedule update cycles improved Schedule reporting provided management a better view Schedule templates Activity level coding allowed enterprise level reporting
  • 16.
    Oracle Primavera P6Schedule Web View
  • 17.
    Microsoft EPM Schedulein Project Professional
  • 18.
    Graphical View ofSchedule Progress Made Outside of the PM Software 0% 10% 20% 30% 40% 50% 60% 70% 80% 90% 100% 21-Sep 5-Oct 19-Oct 2-Nov 16-Nov 30-Nov 14-Dec 28-Dec 11-Jan 25-Jan 8-Feb 22-Feb 8-Mar 22-Mar 5-Apr 19-Apr 3-May 17-May 31-May 14-Jun 28-Jun 12-Jul 26-Jul 9-Aug 23-Aug 6-Sep 20-Sep 4-Oct 18-Oct 1-Nov 15-Nov 29-Nov 13-Dec 27-Dec 10-Jan 24-Jan Week Ending Baseline Plan (Early % Cumulative) Actual (% Cumulative) Baseline Plan (Late % Cumulative) First Construction Contract Awarded May 8 (P) Detail Design Complete - Apr 3 (P) Substantial Completion Dec 23 (P) Preliminary Design Complete - Dec 23(A) Baseline Plan Actual Baseline Critical Status as of 31JAN09 11.8% 7.2% 3.6% Project on Hold -Risk assessment to determine exact scope of work required is ongoing.
  • 19.
    P6 and EPM: ScheduleManagement Differentiators Software Functionality Differences: EPM is “buggy” – errors arise in schedules. It is hard to pinpoint root cause Customer Support for troubleshooting issues is much better with P6 Baseline functionality is better in P6 Unlimited baselines Naming conventions Date stamp for last updated Layout customizations are better in P6
  • 20.
    #2 Reason forProject Portfolio Management: Cost Management Cost Tracking in Project Portfolio Management Software High Level – Total Project Budgets / Forecasts Detailed Level – Cash flow per week Resource coding available for filtering costs Resource Graphs show Cash Flow if detailed in schedule
  • 21.
  • 22.
  • 23.
    Cost Curves inP6 and EPM P6 EPM
  • 24.
    #2 Reason forProject Portfolio Management: Cost Management Software Functionality Differences: EPM is “buggy” – forecast may change when merely opening a project. Hard to pinpoint root cause Customer Support for troubleshooting issues is much better with P6 Graphical cash flow curves are possible with either tool for the detailed activity level data, but portfolio high-level cash flows are not as simple
  • 25.
    #3 Reason forProject Portfolio Management: Project Selection Assistance Project Selection encompasses the initial phases a project goes through prior to execution Request Rough Scoping Initial Approval Detailed Execution Planning Final Approval Execution Which Projects Should Be Approved?
  • 26.
    Project Status =Most Important Field Proposed Approved In Close Out Complete Cancelled Deferred Proposed SG1 Approved SG2 Approved Complete Cancelled Deferred Company B’s Options:Company A’s Options: Project Status Code is shown in every view and report Approvals are milestones in every schedule
  • 27.
    Elements of ProjectSelection What is not kept in codes and milestones? The general story behind status changes. Why is this important? Everyone wants to know which meeting Project X got approved. How did we incorporate this? P6: Project Level Notebook. EPM: Multi-line text field in PWA
  • 28.
    Project Notes =Story Line to the Project Microsoft EPM View: Project Web Application Disadvantage: Need to Open Project in PWA each time to view or edit notes
  • 29.
    Company A’s NotebookExample 0082 Project Notebook Example: Project Team Update 13Apr11 (AVS/PTeam): Per DJW- a meeting to discuss BCRB status to be held on 15Apr11. 30Mar11 (DJW) BCRB pending 02Mar11 (AVS/PTeam):Wait in for BCRB 16Feb11 (AVS/PTeam) Waiting for APO to Implement SOP. 0814Feb11 (DJW) Per CC meeting on 07Feb11 : · Change was discussed to whether proceed with the change or cancel. It was decided by the subcommittee to proceed with the change since it captures the rational to remove the need to complete a CIP between two consecutive make-ups of the same buffer in Suite Support. Change endorsed by all stakeholders; however, still pending the BCRB endorsement form 24Jan11 (AVS): Per email from DJW: 'Waiting on a memo. There will be no PQs required. Following that, the change cannot be made until Demo period is over and another regulatory round is complete. Expect Jun 2011 at this point.' 11Jan11 (DJW): Meeting on 07 Jan11 determined that there is reg impact. Preapproval not required. No testing required. Change control to be completed. Target usage and sign off of CC for end of demo runs(May/June timeframe). 05Jan11 (AVS): No Change per DJW. Still waiting on Regulatory response. Moved DD and maintained RA approval date in 21Jan2011. Rebaseline? Oracle Primavera’s Structure for Project and Activity Notebooks is a rich-text format and is more functional than Microsoft’s.
  • 30.
    Microsoft Enterprise Project Management(EPM) View of Projects Status Indicators Cancelled SG2 Approved SG1 Approved Proposed Problem Caution OK No Info Schedule/Cost Indicators
  • 31.
    Oracle Primavera P6v7 View of Projects
  • 32.
    Project Selection Which ProjectsFit in the Budget? Budgets for next year were requested between July and September based on best info at that time Budgets approved in October Project portfolio constantly in flux How to decide which projects are “IN”? PRIORITIZATION!
  • 33.
    Project Prioritization Project Request 4Business Drivers Enterprise Project Management P6 > Project Level User Defined Field Microsoft > Portfolio Analysis Ranking of Projects 1) Project B (top priority) 2) Project F 3) … 4) Project L 5) Project M 6) Project C (lowest priority)
  • 34.
    Company A’s BusinessDrivers Impact cGMP Compliance Worker Safety & Health Environmental Impact Critical Could result in product recall, warning letter, regulatory or enforcement action, severe adverse effect or consent decree. Could result in a fatality event and/or willful regulatory citation. Could result in significant environmental impact beyond the site boundaries and/or regulatory action and/or legal liability. Major Could result in critical regulatory observation, severe product quality complaint, or equivalent. Could result in non-compliance with approved Level I/II. Could result in serious injury and/or exposure to workplace health-hazards and/or regulatory compliance violation. Could result in significant environmental impact in excess of permitted levels and/or regulatory compliance violation. Moderate Could result in batch rejections, major observation or multiple minor observations. Could result in injury or health impact. Could result in and/or enhances current environmental compliance. Facilitates meeting internal environmental objectives. Marginal Could result in internal observation. Could result in minor injury to personnel, no compliance issues/concerns. Could result in and/or required to meet current standards. Negligible Enhances compliance in existing operations. Safety enhancement. Environmental enhancement.
  • 35.
    Scoring Behind theProject Request to Calculate Project Score
  • 36.
    Company A’s Excel-BasedProject Request Form Showing Project Business Driver
  • 37.
    Company A’s OraclePrimavera P6 Web Portfolio View – Graphical Output
  • 38.
    Company B’s BusinessDrivers Compliance Need Operational Need Capability Improvement Unit Cost Improvement These were ranked 0, 1, 2, or 3 based on strength and urgency. Compliance and Operational need were weighted higher than Capability and Unit Cost. Microsoft Enterprise Project Management (EPM) produced a “pair- wise” comparison of projects and ranked them in order of priority Leadership teams judged the prioritization output and made adjustments to keep business drivers application consistent
  • 39.
    Microsoft EPM Viewof Project Prioritization –Driver Prioritization
  • 40.
    Microsoft EPM Viewof Project Prioritization – Business Drivers Manual Data Input from Project Request Form
  • 41.
    Microsoft EPM Viewof Project Prioritization - Table Output Priority Values are Relative Within Each Portfolio – Not Consistent Enterprise Wide
  • 42.
    Company B’s MicrosoftEPM View of Project Prioritization – Graphical Output
  • 43.
    Company B’s MicrosoftExcel View of Project Prioritization – Export Advantage: These weekly Excel spreadsheets were easy to distribute, modify and filter Disadvantage: EPM does not export Business Driver data in the same file so two exports had to be merged prior to each distribution, not able to include prioritization on standard reports
  • 44.
    Company A’s PortfolioReport Generated by Oracle Primavera P6 The Project Score is a Project Code that is easily included on any view or report
  • 45.
    Project Prioritization -Commonalities Both Companies: Weekly Review of Priorities by Leadership Team Management Stood Behind Focus on Business Drivers Final Score / Ranking Drove Project Prioritization Prioritization Drove Resource Assignments Forcing In Allowed, but Not Commonly Utilized Systems Do Not Track Changes to Drivers Prioritization Drove Inclusion in Overall Portfolio Budget
  • 46.
    Project Prioritization -Differences Software Generation of Prioritization: P6 Uses Standard Mathematical Formula Projects Easily Ranked Against Each Other Example: Score 14 vs. Score 12 Score is an Enterprise-wide Project Code Microsoft Uses Pair wise Comparison Projects Ranked within Portfolios and Score Not Easily Transferable Absolute Value of Project’s Priority Difficult to Calculate Rankings Kept in Separate Module of EPM, Not Project Code
  • 47.
    Project Prioritization: Theoretical vs.Practical Both P6 and EPM use a calculation of business drivers to score projects Theoretically there are many more attributes related to whether or not the project should be approved There is considerable maturity still left to be gained at pharmaceutical companies in regards to project selection Net Present Value and Return on Investment are not factored in Overall financial implications of doing projects versus not doing them need to be better modeled to produce overall Value to the company Better modeling requires more time spent on scoping the projects
  • 48.
    P6 Portfolio Viewof Value Over Time
  • 49.
    Resource Forecasting High LevelResource Estimating – Immature Process Ballpark Total Hours Provided by Each Department Estimates Not Input into EPM or P6 Estimates Used for Approval Decision Company A Tried Implementing a Separate Resource Management Tool, no integration to project schedules Company B did not have a mechanism for calculating total resource forecasts across the portfolio Resource Forecasting = Political Black Hole
  • 50.
    P6 Resource HistogramBased on Roles
  • 51.
    Microsoft EPM orOracle Primavera P6? Strengths to Either System: One Single Source of Project Information Schedule Maintenance and Automatic Roll Up / Reporting The Ability for Future Maturity: Improved Portfolio Management Cost Forecasting / Tracking Resource Forecasting / Tracking Flexibility of Reporting for Varied Audiences Business Intelligence Data Mining
  • 52.
    Microsoft EPM orOracle Primavera P6? Oracle Primavera P6 Oracle Primavera P6 Wins My Heart Speed! Efficiency of Linking Tasks Between Project Schedules Efficiency of Switching Between Projects for Common Tasks like updating Project Notebooks Web Client Customization Features and Usability Speed!
  • 53.
    Why Did CompanyA Choose Primavera vs. Other Portfolio Management Tools? Centralized Database (no file revisions) Accessible via web portal – included with licenses Future Integration Capabilities with SAP and/or Process Scheduling Software Email Notifications about Issues WBS Standardization In-House Expertise – Site has utilized Primavera for 10+ years
  • 54.
    Why Did CompanyB Choose Microsoft EPM vs. Other Portfolio Management Tools? Company Culture Liked Microsoft Project Believed MS Project is Easier to Use Less Training Required for PMs
  • 55.
    Based on therobust capabilities of the Oracle Primavera P6 solution compared to the relatively less mature Microsoft Enterprise Project Management, the preference for a company with no other influences should be to Use Oracle Primavera P6. Certain company cultures may already be entrenched in Microsoft technologies and may shy away from supporting a major Oracle-based solution due to corporate standards. This would need to be weighed with the long term commitment that will be made to the project management solution and the various headaches that will need to be overcome by the project management departmental software users and administrators. Microsoft EPM or Oracle Primavera P6? CONCLUSION
  • 56.
    Extra Slides forReference The following slides are included for reference purposes
  • 57.
    References GMP http://en.wikipedia.org/wiki/Good_manufacturing_practice Oracle Primavera http://www.oracle.com/us/products/applications/primavera Microsoft EnterpriseProject Management http://www.microsoft.com/project/en-us/solutions.aspx Project Server 2010: A financial management solution for projects, programs and portfolios (white paper) http://go.microsoft.com/fwlink/p/?LinkId=216201 Portfolio strategy with Project Server 2010 (white paper) http://go.microsoft.com/fwlink/p/?LinkId=194203
  • 59.
    Thank You Thanks forlistening to my story. Feel free to contact me with questions or comments. Email: sbenjamin@tauruspcc.com Linked In: http://www.linkedin.com/in/sarahbenjamin
