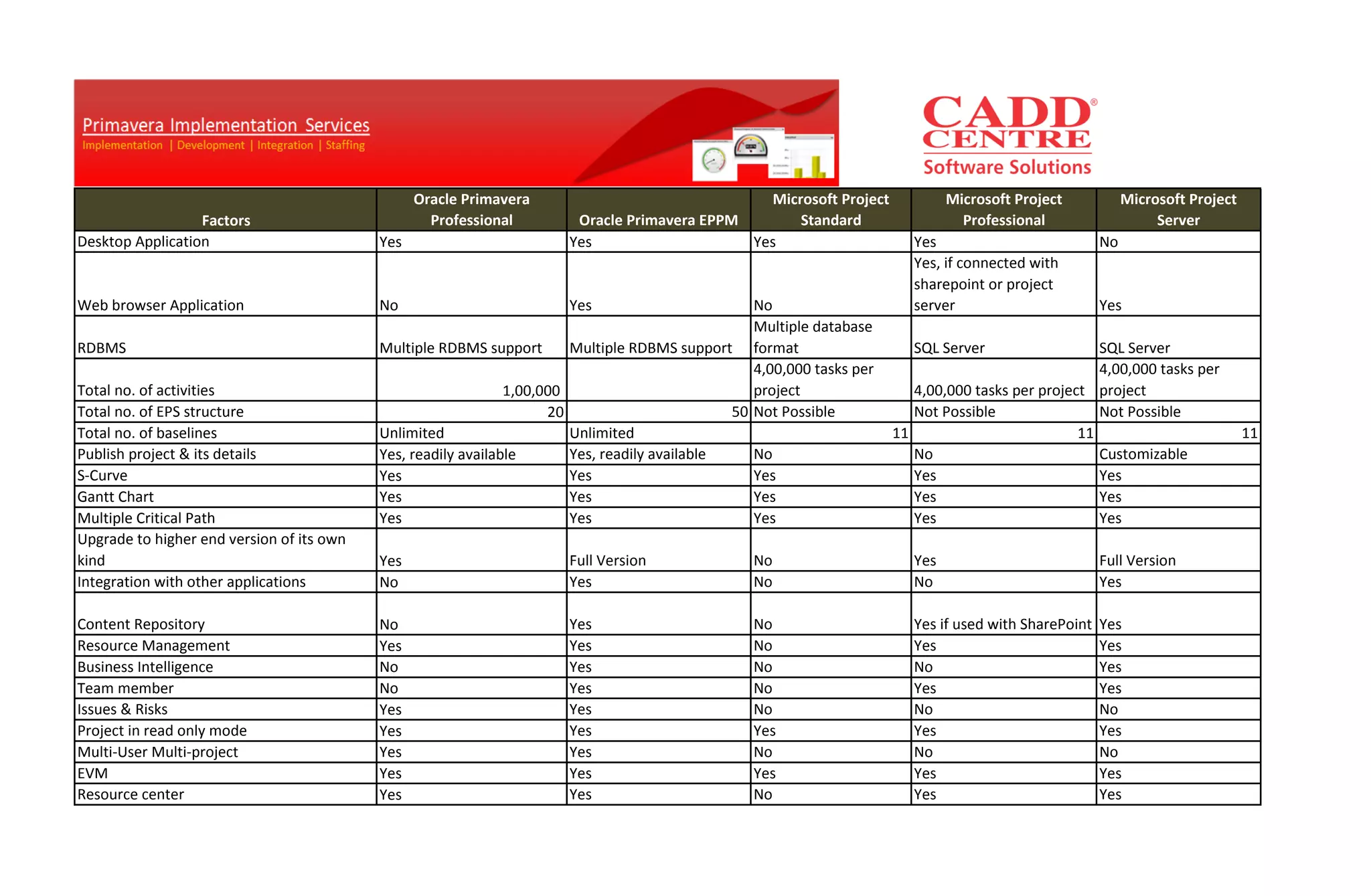

Factors
Oracle Primavera
Professional Oracle Primavera EPPM
Microsoft Project
Standard
Microsoft Project
Professional
Microsoft Project
Server
Desktop Application Yes Yes Yes Yes No
Web browser Application No Yes No
Yes, if connected with
sharepoint or project
server Yes
RDBMS Multiple RDBMS support Multiple RDBMS support
Multiple database
format SQL Server SQL Server
Total no. of activities 1,00,000
4,00,000 tasks per
project 4,00,000 tasks per project
4,00,000 tasks per
project
Total no. of EPS structure 20 50 Not Possible Not Possible Not Possible
Total no. of baselines Unlimited Unlimited 11 11 11
Publish project & its details Yes, readily available Yes, readily available No No Customizable
S-Curve Yes Yes Yes Yes Yes
Gantt Chart Yes Yes Yes Yes Yes
Multiple Critical Path Yes Yes Yes Yes Yes
Upgrade to higher end version of its own
kind Yes Full Version No Yes Full Version
Integration with other applications No Yes No No Yes
Content Repository No Yes No Yes if used with SharePoint Yes
Resource Management Yes Yes No Yes Yes
Business Intelligence No Yes No No Yes
Team member No Yes No Yes Yes
Issues & Risks Yes Yes No No No
Project in read only mode Yes Yes Yes Yes Yes
Multi-User Multi-project Yes Yes No No No
EVM Yes Yes Yes Yes Yes
Resource center Yes Yes No Yes Yes

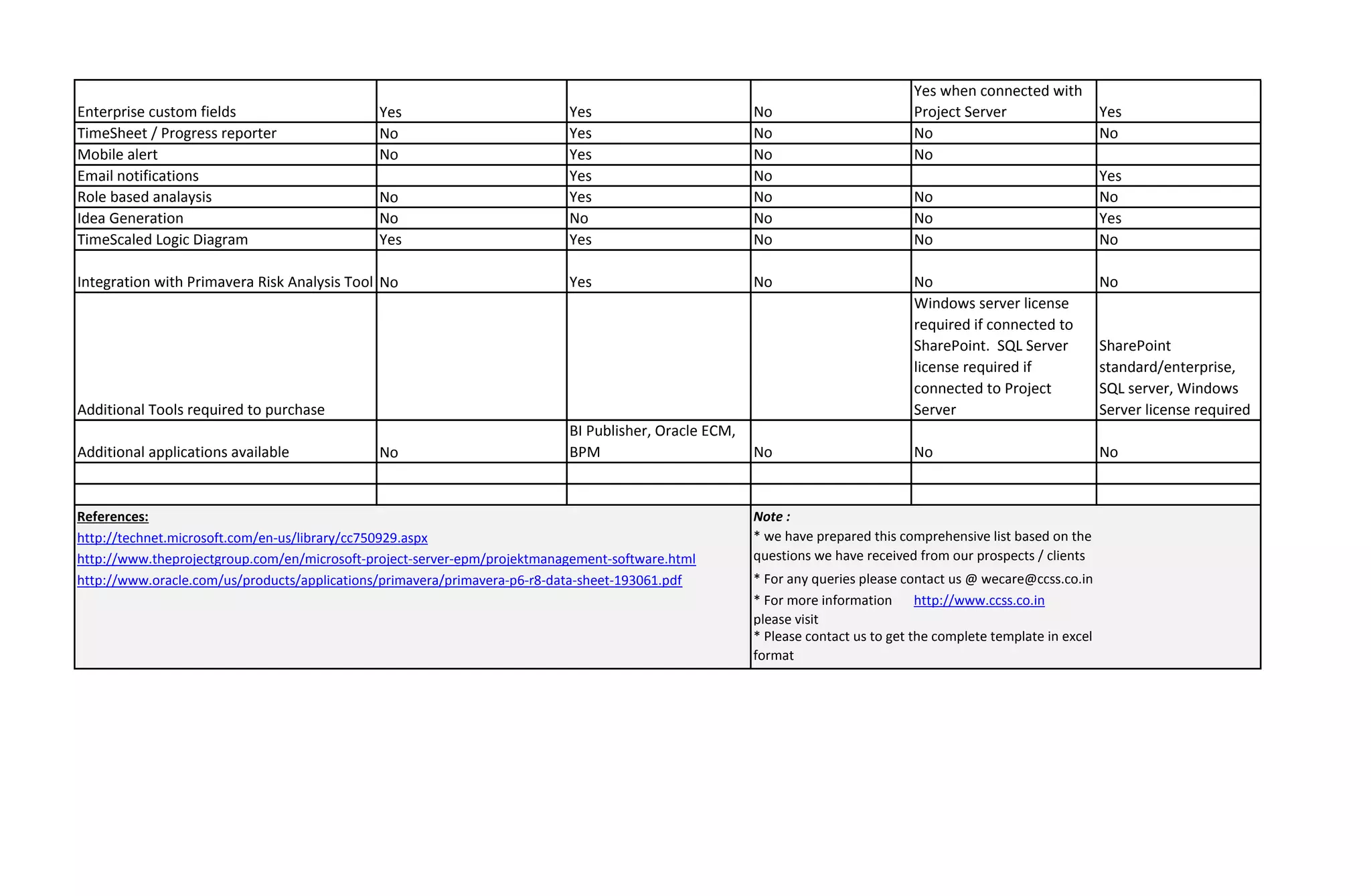

Enterprise custom fields Yes Yes No
Yes when connected with
Project Server Yes
TimeSheet / Progress reporter No Yes No No No
Mobile alert No Yes No No
Email notifications Yes No Yes
Role based analaysis No Yes No No No
Idea Generation No No No No Yes
TimeScaled Logic Diagram Yes Yes No No No
Integration with Primavera Risk Analysis Tool No Yes No No No
Additional Tools required to purchase
Windows server license
required if connected to
SharePoint. SQL Server
license required if
connected to Project
Server
SharePoint
standard/enterprise,
SQL server, Windows
Server license required
Additional applications available No
BI Publisher, Oracle ECM,
BPM No No No
