Session 1

Course Overview
Emanuele Della Valle
http://home.dei.polimi.it/dellavalle

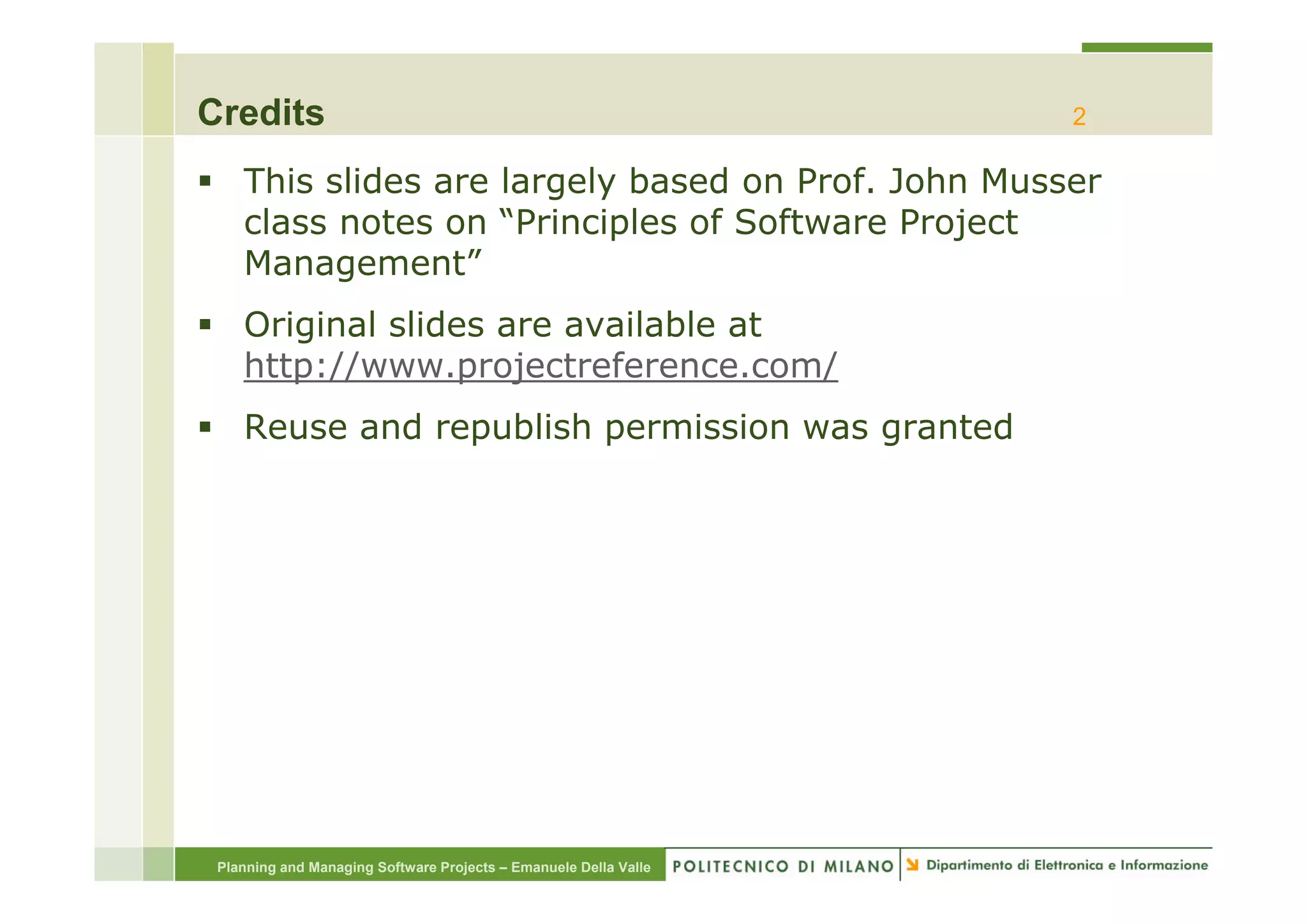

Credits                                                           2

    This slides are largely based on Prof. John Musser
    class notes on “Principles of Software Project
    Management”
    M            t”
    Original slides are available at
    http://www.projectreference.com/
    htt //           j t f           /
    Reuse and republish permission was granted




 Planning and Managing Software Projects – Emanuele Della Valle
Today                                                            3

   Course basics, administrative items
   Introductions
   Fundamentals
   Classic Mi t k
   Cl   i Mistakes




Planning and Managing Software Projects – Emanuele Della Valle
Course basics, administrative items

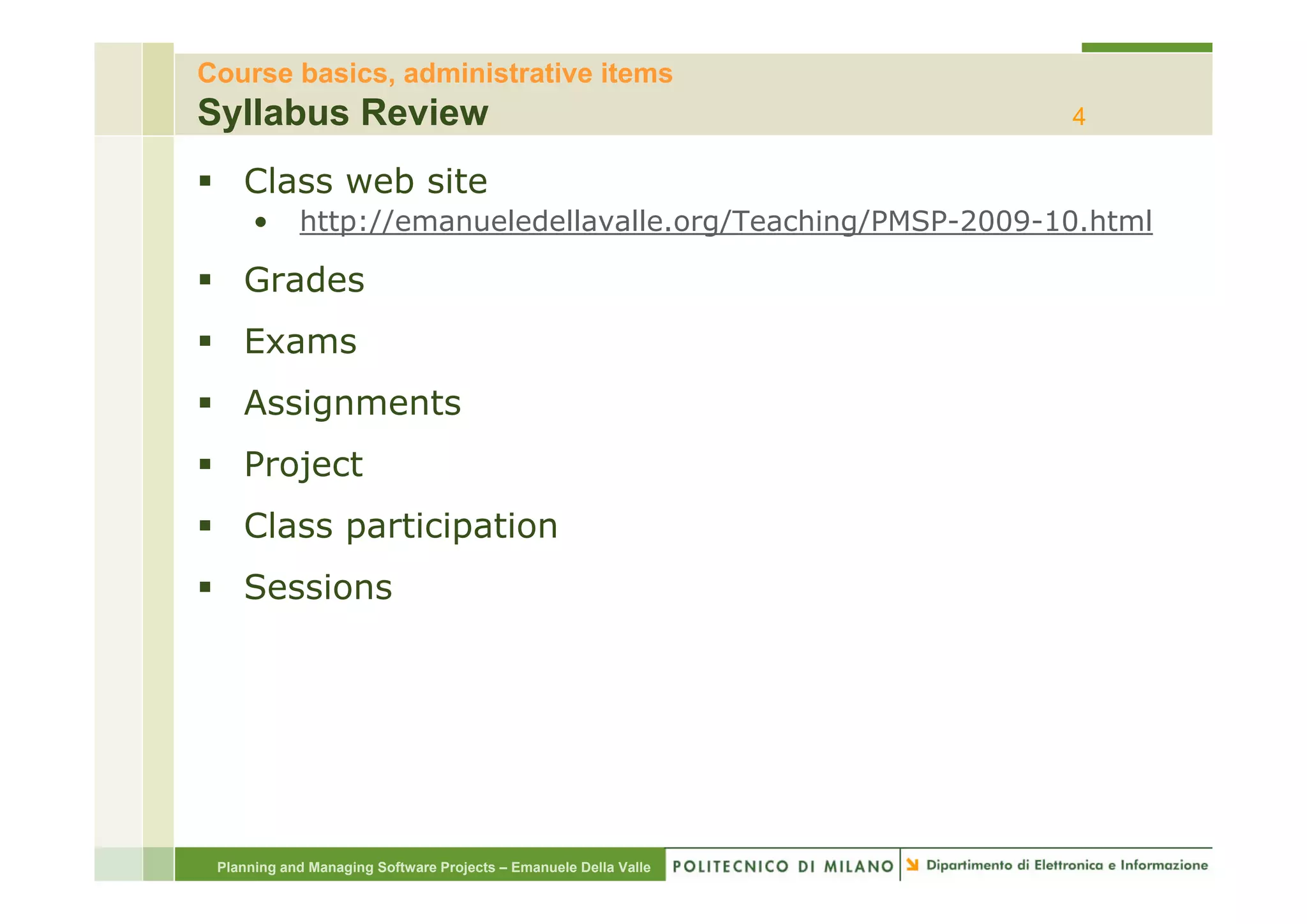

Syllabus Review                                                   4

    Class web site
      •     http://emanueledellavalle.org/Teaching/PMSP-2009-10.html

    Grades
    Exams
    Assignments
    Project
    Class participation
    Sessions




 Planning and Managing Software Projects – Emanuele Della Valle
Course basics, administrative items

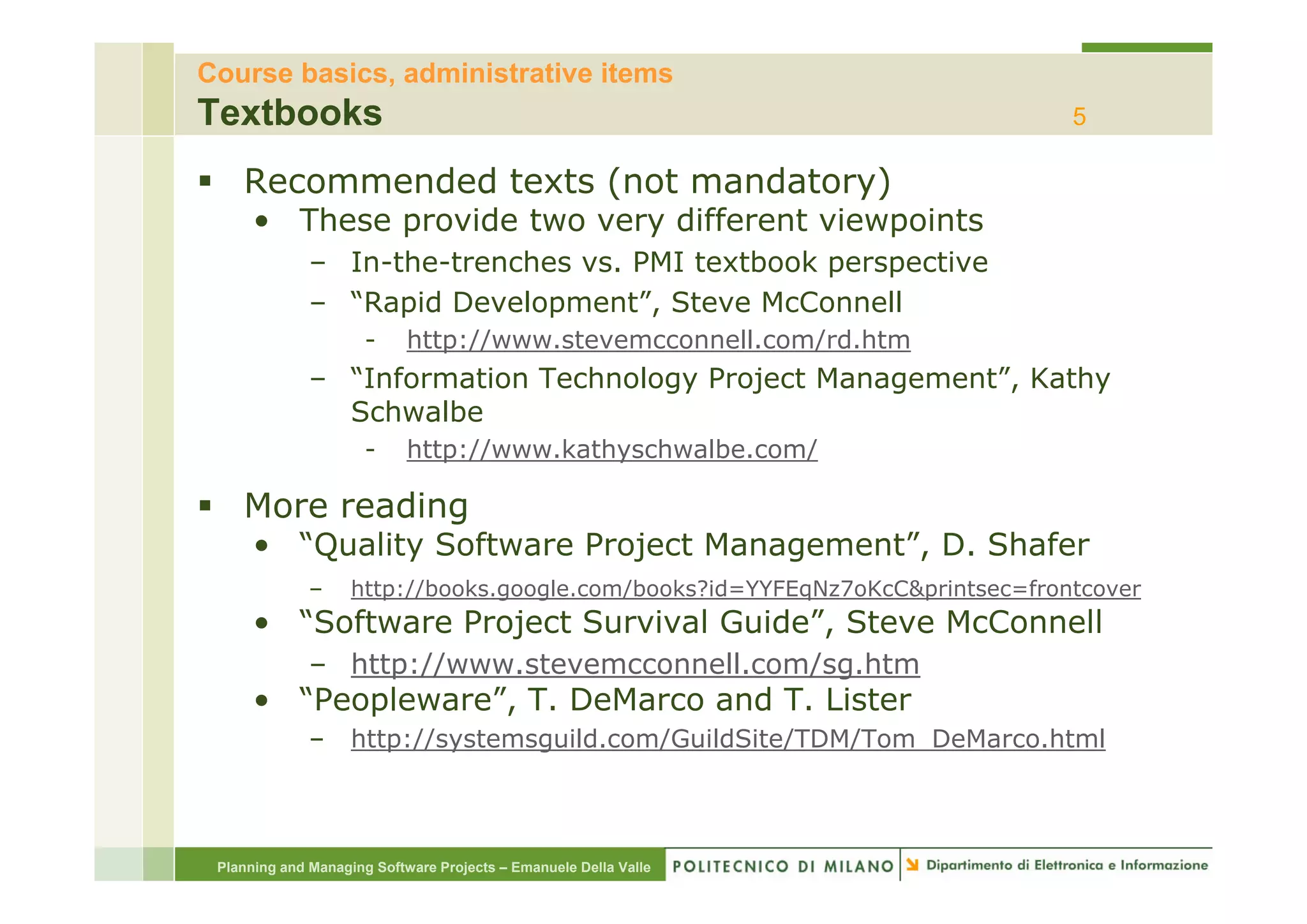

Textbooks                                                                      5

    Recommended texts (not mandatory)
      • These provide two very different viewpoints
              – I th t
                In-the-trenches vs. PMI textbook perspective
                            h           t tb k          ti
              – “Rapid Development”, Steve McConnell
                      -     http://www.stevemcconnell.com/rd.htm
              – “Information Technology Project Management”, Kathy
                Schwalbe
                      -     http://www.kathyschwalbe.com/
                               p           y

    More reading
      • “Quality Software Project Management”, D. Shafer
              –     http://books.google.com/books?id=YYFEqNz7oKcC&printsec=frontcover
      • “Software Project Survival Guide”, Steve McConnell
              – http://www.stevemcconnell.com/sg.htm
      • “Peopleware”, T. DeMarco and T. Lister
              –     http://systemsguild.com/GuildSite/TDM/Tom_DeMarco.html




 Planning and Managing Software Projects – Emanuele Della Valle
Course basics, administrative items
Basics                                                            6

    Essential elements of software project management
    Practical, rapid development focus
    Real-world case studies
      • And other examples like j
                      p         job interviews
    Highly interactive
    Dry as toast?




 Planning and Managing Software Projects – Emanuele Della Valle
Course basics, administrative items

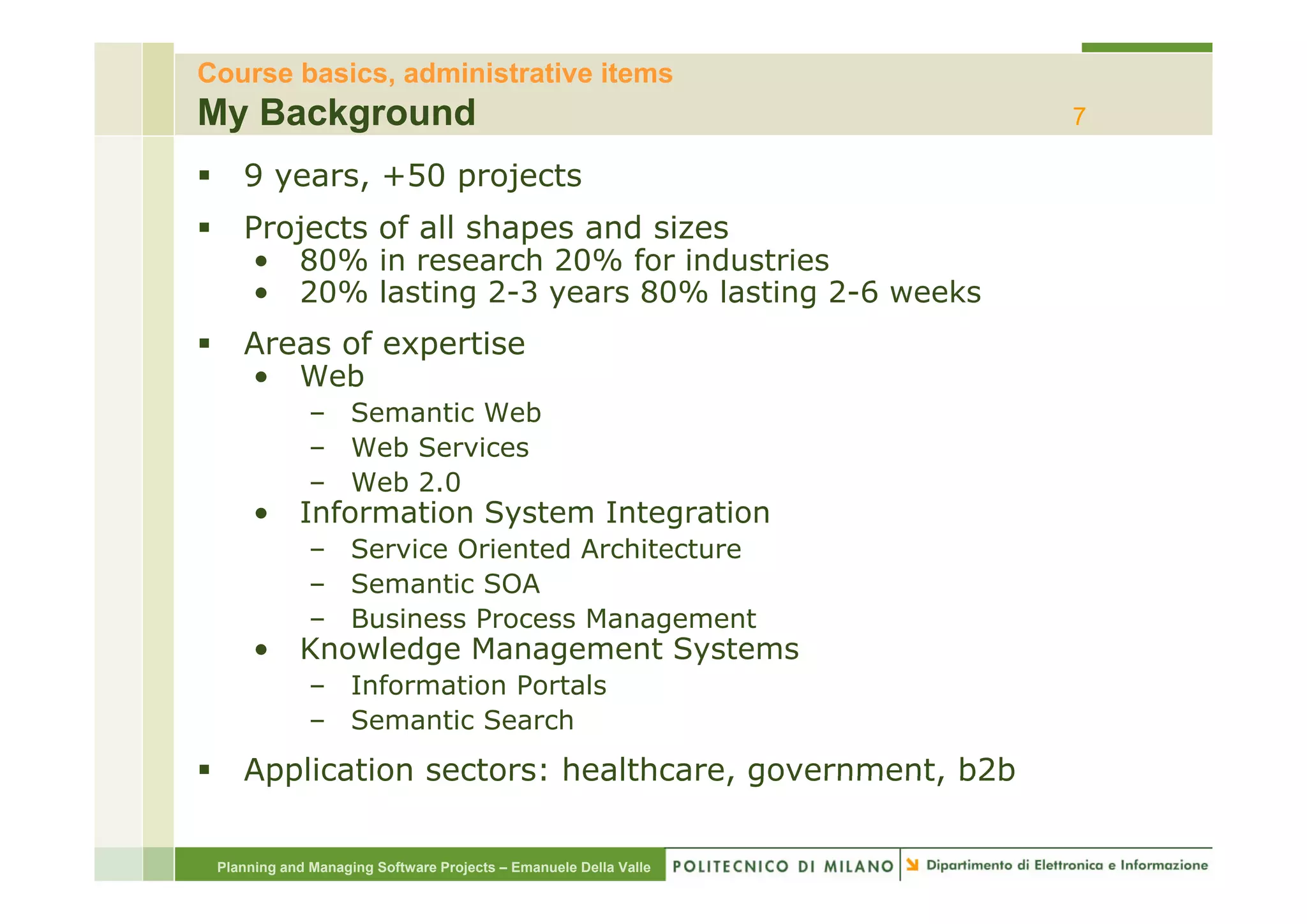

My Background                                                     7

    9 years, +50 projects
    Projects of all shapes and sizes
    • 80% in research 20% for industries
             i         h      f i d t i
    • 20% lasting 2-3 years 80% lasting 2-6 weeks
    Areas of expertise
               p
    • Web
              – Semantic Web
              – Web Services
              – Web 2.0
      •     Information System Integration
              – Service Oriented Architecture
              – Semantic SOA
              – Business Process Management
      •     Knowledge Management Systems
              – Information Portals
              – Semantic Search
    Application sectors: healthcare, government, b2b
                         healthcare government

 Planning and Managing Software Projects – Emanuele Della Valle
Course basics, administrative items

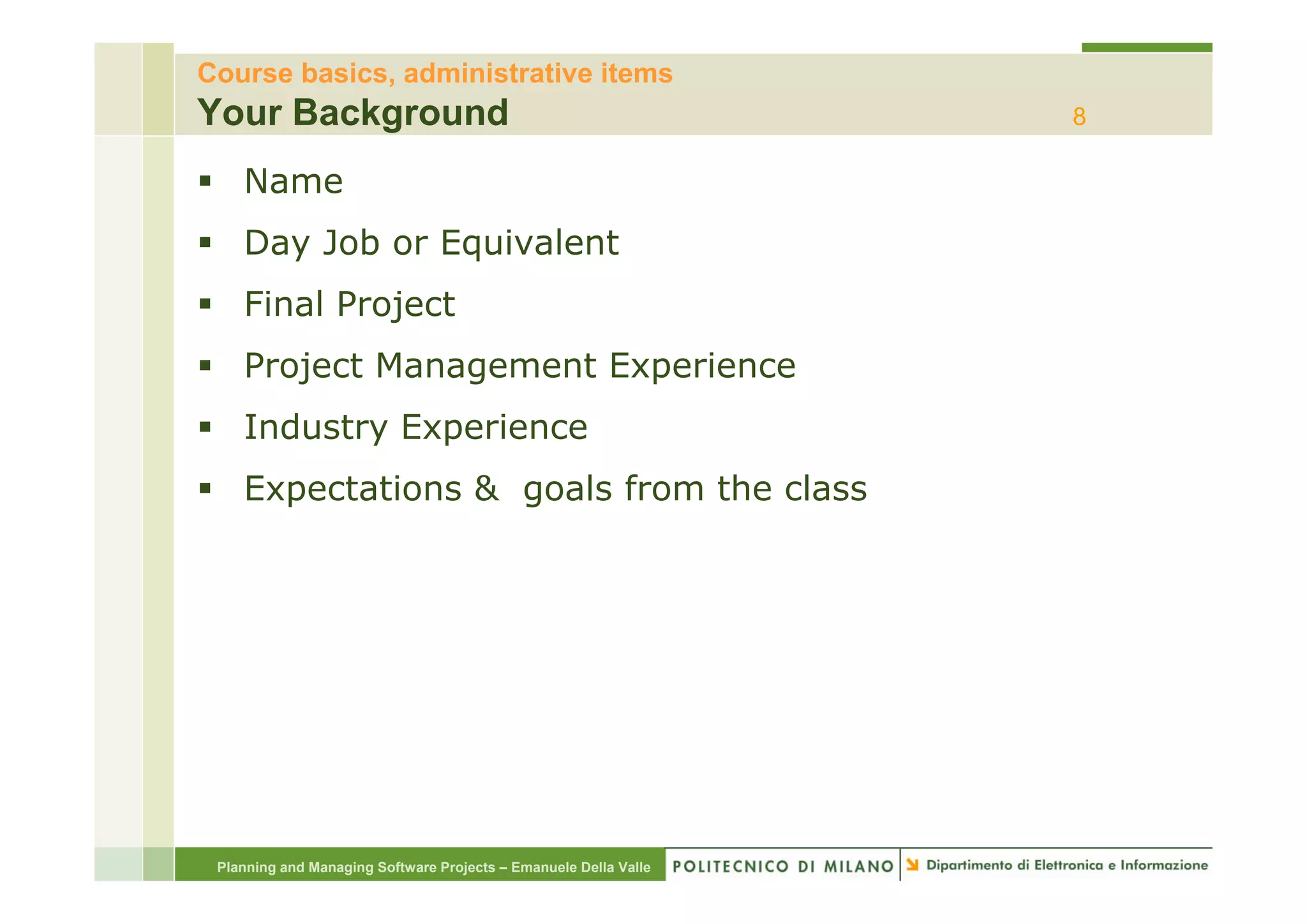

Your Background                                                   8

    Name
    Day Job or Equivalent
    Final Project
    Project M
    P j t Management Experience
                   tE     i
    Industry Experience
    Expectations & goals from the class




 Planning and Managing Software Projects – Emanuele Della Valle
Introduction
The Field                                                                              9

    Jobs: where are they?
     • http://dice.com PM vs. Developers
    Professional Organizations
    • Project Management Institute (PMI) (pmi.org)
    • Software Engineering Institute (
                   g       g         (SEI)
                                         )
    • IEEE Software Engineering Group
    Certifications
    • PMI PMP
              – http://en.wikipedia.org/wiki/Project_Management_Professional

    The “PMBOK” – PMI Body of Knowledge
         PMBOK
    Tools
    • MS Project
              – Available in A3.3 where we will go for class 6
              – http://office.microsoft.com/project
      •     Other similar tools
              –     http://en.wikipedia.org/wiki/List_of_project_management_software

 Planning and Managing Software Projects – Emanuele Della Valle
Introduction

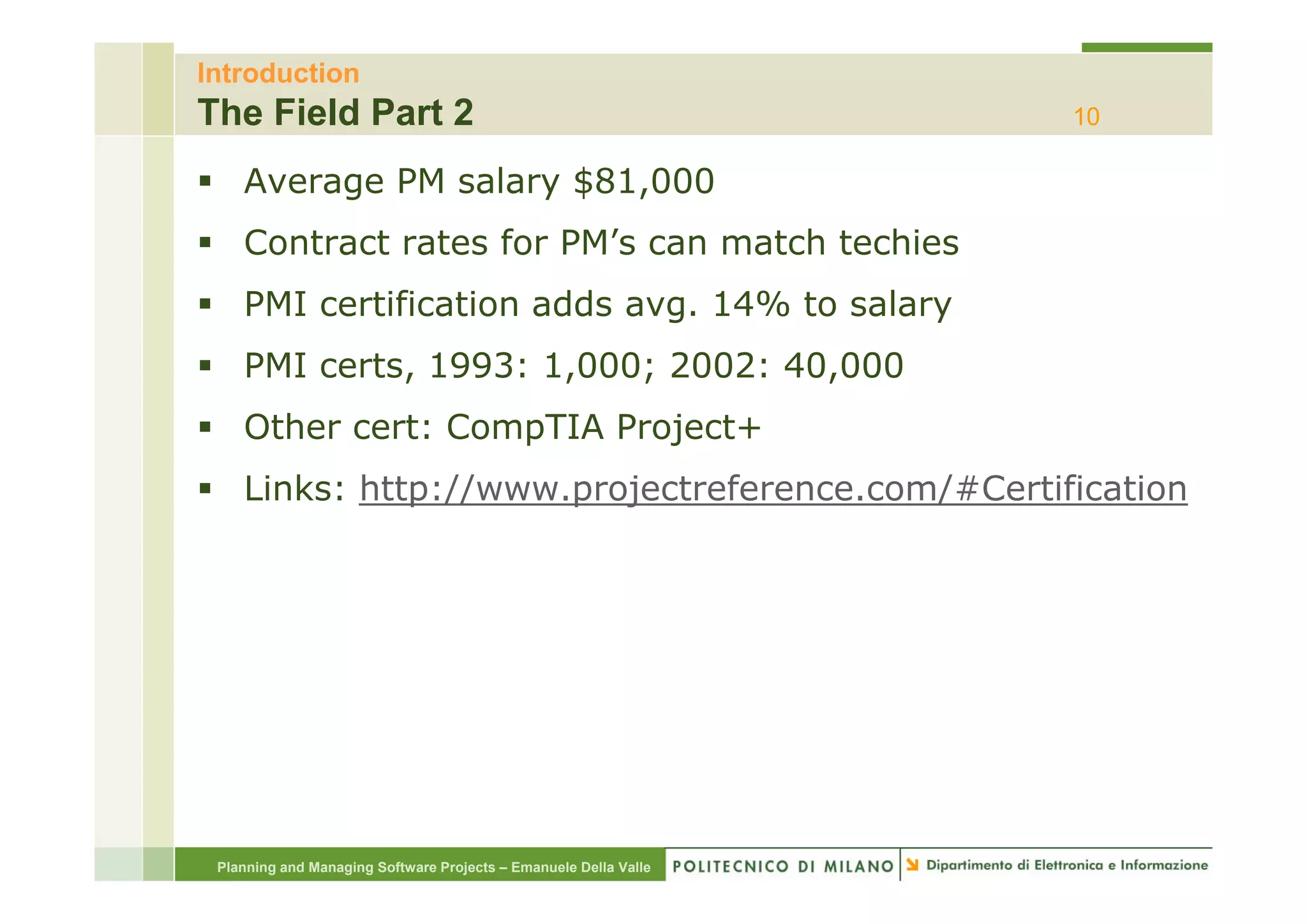

The Field Part 2                                                  10

    Average PM salary $81,000
    Contract rates for PM s can match techies
                       PM’s
    PMI certification adds avg. 14% to salary
    PMI certs, 1993 1,000; 2002: 40,000
           t 1993: 1 000 2002 40 000
    Other cert: CompTIA Project+
    Links: http://www.projectreference.com/#Certification




 Planning and Managing Software Projects – Emanuele Della Valle
Introduction
Job Fundamentals                                                  11

    Skills required
    PM Positions and roles
    The process




 Planning and Managing Software Projects – Emanuele Della Valle
Introduction - Job Fundamentals
Project Management Skills                                         12

    Leadership
    Communications
    Problem Solving
    Negotiating
    N   ti ti
    Influencing the Organization
    Mentoring
                            p
    Process and technical expertise




 Planning and Managing Software Projects – Emanuele Della Valle
Introduction - Job Fundamentals

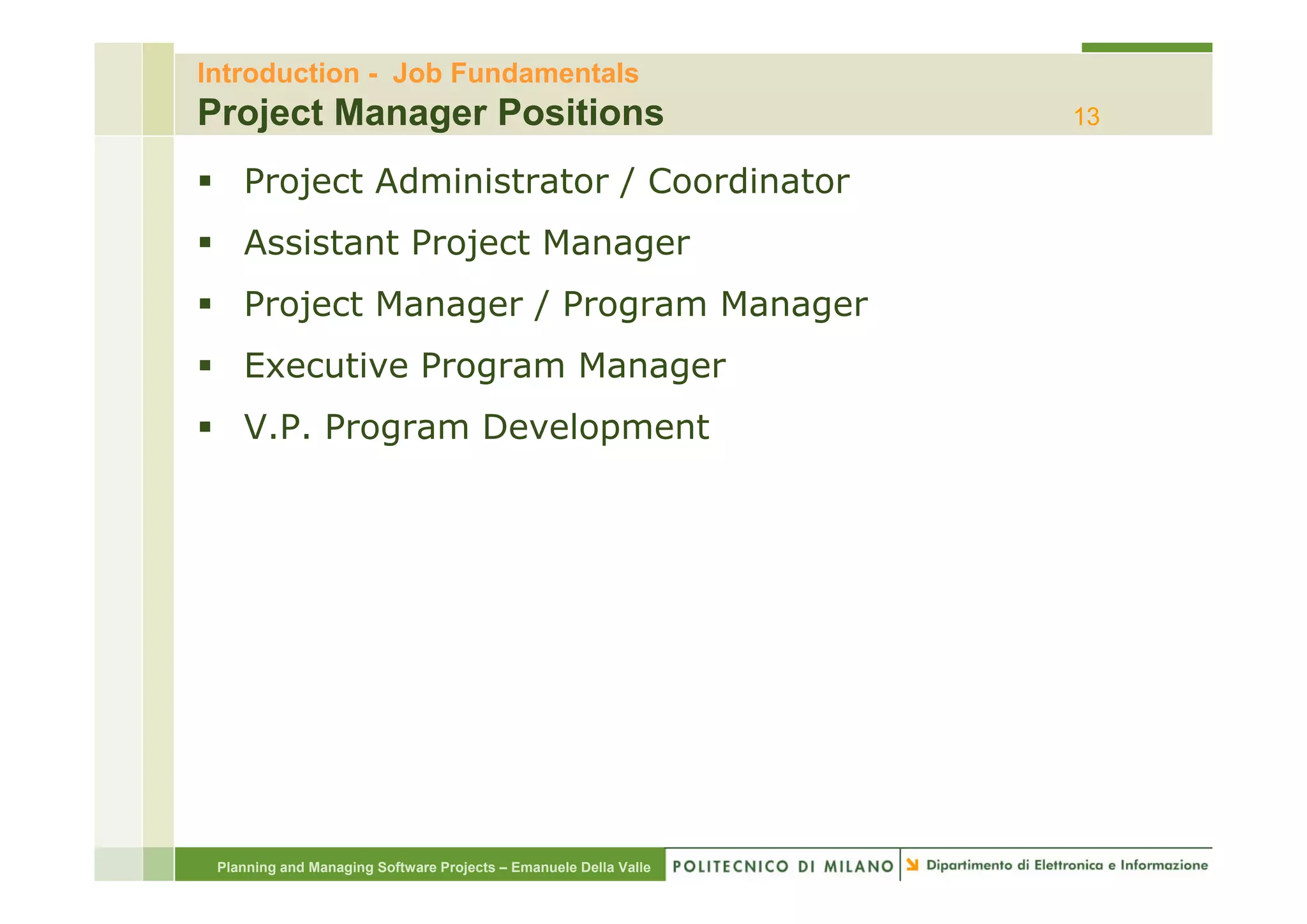

Project Manager Positions                                         13

    Project Administrator / Coordinator
    Assistant Project Manager
    Project Manager / Program Manager
    Executive P
    E    ti   Program M
                      Manager
    V.P. Program Development




 Planning and Managing Software Projects – Emanuele Della Valle
Introduction

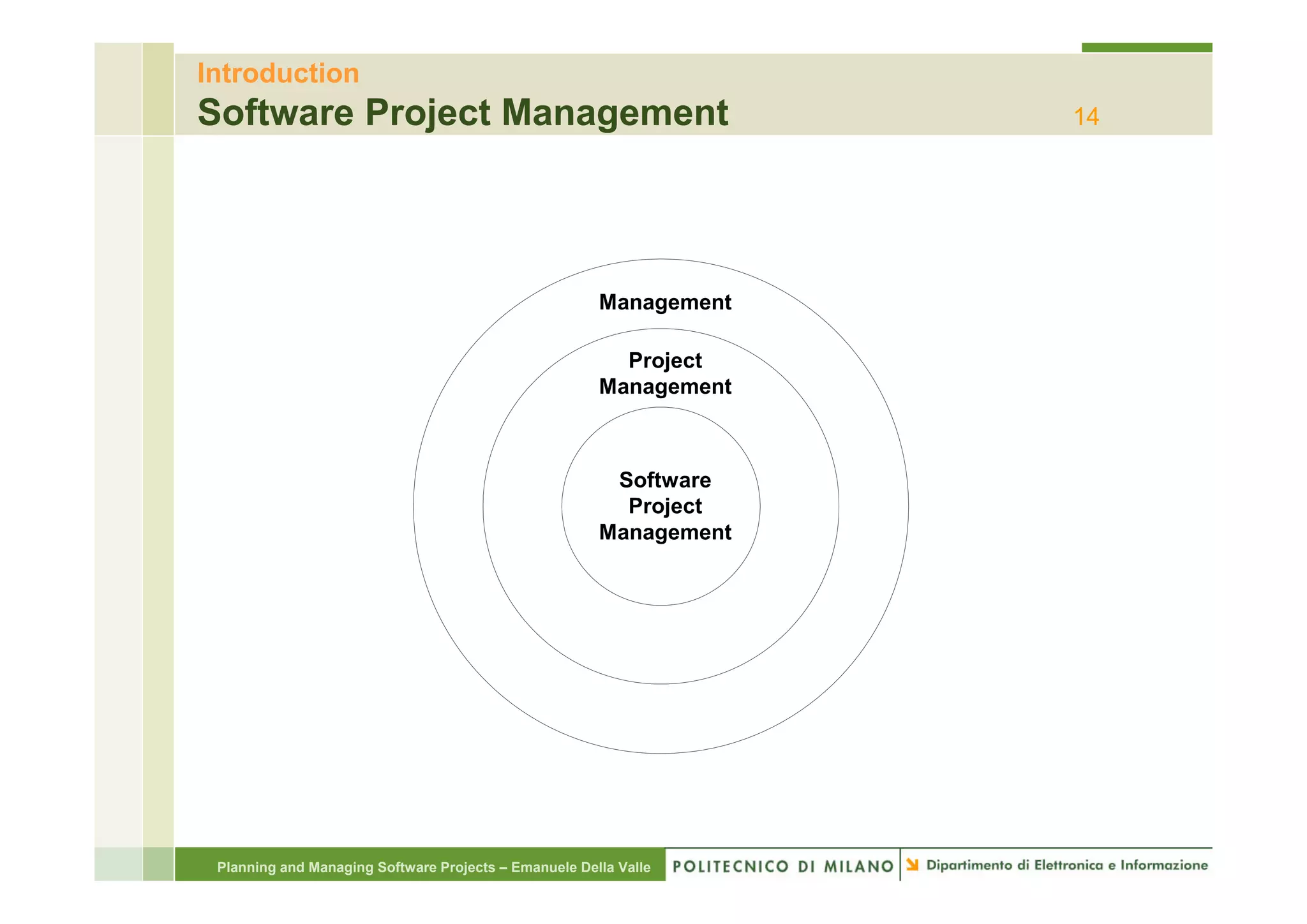

Software Project Management                                         14




                                                       Management

                                                         Project
                                                       Management



                                                        Software
                                                         Project
                                                       Management




 Planning and Managing Software Projects – Emanuele Della Valle
Introduction

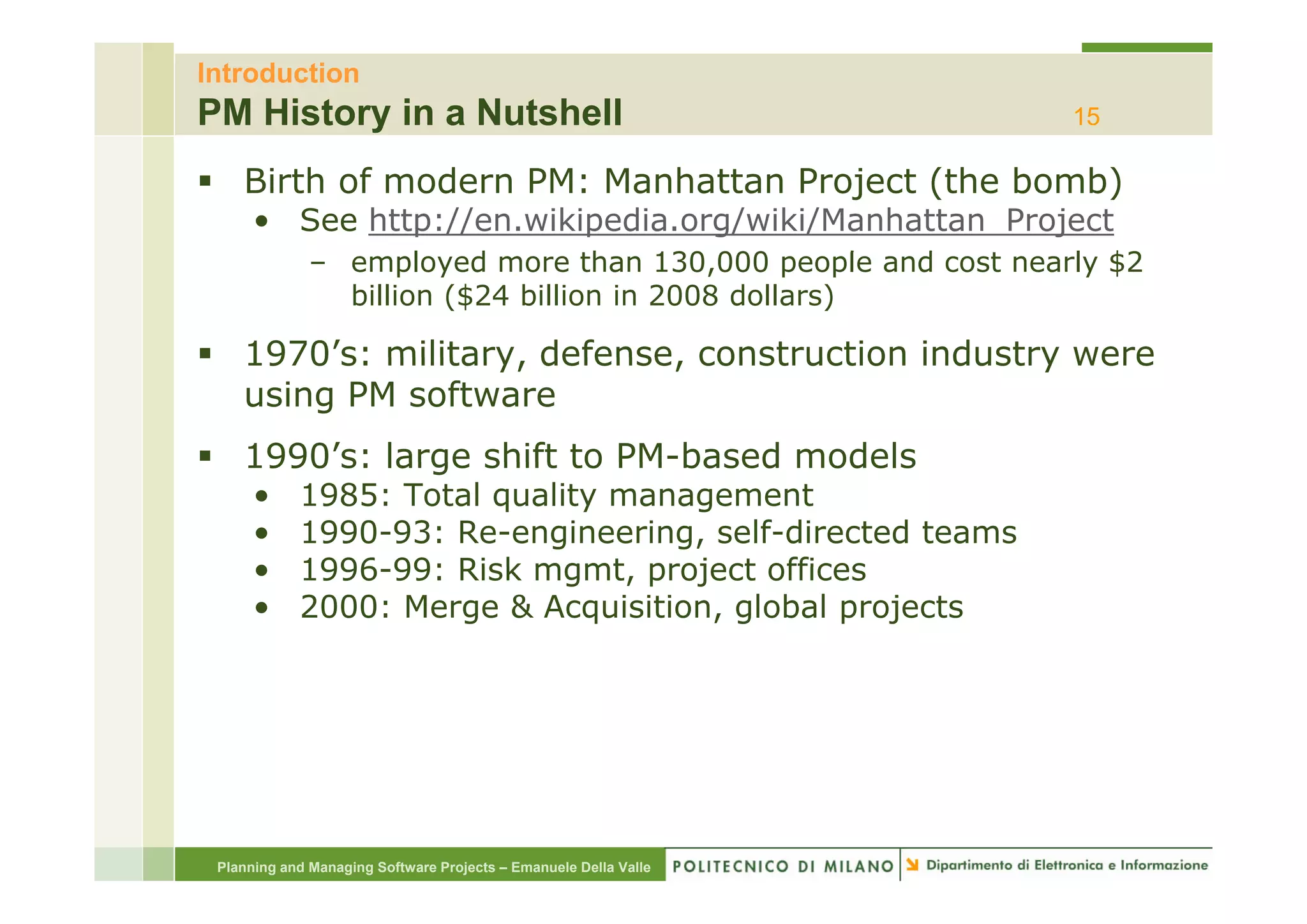

PM History in a Nutshell                                           15

    Birth of modern PM: Manhattan Project (the bomb)
      • See http://en.wikipedia.org/wiki/Manhattan_Project
              – employed more th
                      l   d        than 130,000 people and cost nearly $2
                                        130 000       l  d    t     l
                billion ($24 billion in 2008 dollars)

    1970 s: military, defense,
    1970’s: military defense construction industry were
    using PM software
    1990 s:
    1990’s: large shift to PM-based models
                           PM based
      •     1985: Total quality management
      •     1990-93: Re-engineering, self-directed teams
      •     1996-99:
            1996 99: Risk mgmt project offices
                          mgmt,
      •     2000: Merge & Acquisition, global projects




 Planning and Managing Software Projects – Emanuele Della Valle
Introduction
Project Management                                                           16

    What’s a project?
    PMI definition
      • A project is a temporary endeavor undertaken to create
        a unique product or service
              – “Temporary”
                 Temporary
                      -     Can be years
                      -     Result can be lasting
                      -     Team can be temporary
              – “Unique”
                      -     Ex: thousands of buildings, but each is unique

    Progressively elaborated
      • With repetitive elements
      • Scope should be constant even as elaboration happens
    A project manager
      • Analogy: conductor, coach, captain

 Planning and Managing Software Projects – Emanuele Della Valle
Introduction
Project vs. Program Management                                    17

    What’s a ‘program’?
    Mostly differences of scale
    Often a number of related projects
    Longer than projects
    L      th      j t
    Definitions vary
    Ex: Program Manager for OpenOffice




 Planning and Managing Software Projects – Emanuele Della Valle
Introduction
Interactions / Stakeholders                                       18

    As a PM, who do you interact with?
    Project Stakeholders
      •     Project sponsor
      •     Executives
      •     Team
      •     Customers
      •     Contractors
      •     Functional managers
    Managing all stakeholder Expectations is challenging
      • conflict




 Planning and Managing Software Projects – Emanuele Della Valle
Introduction

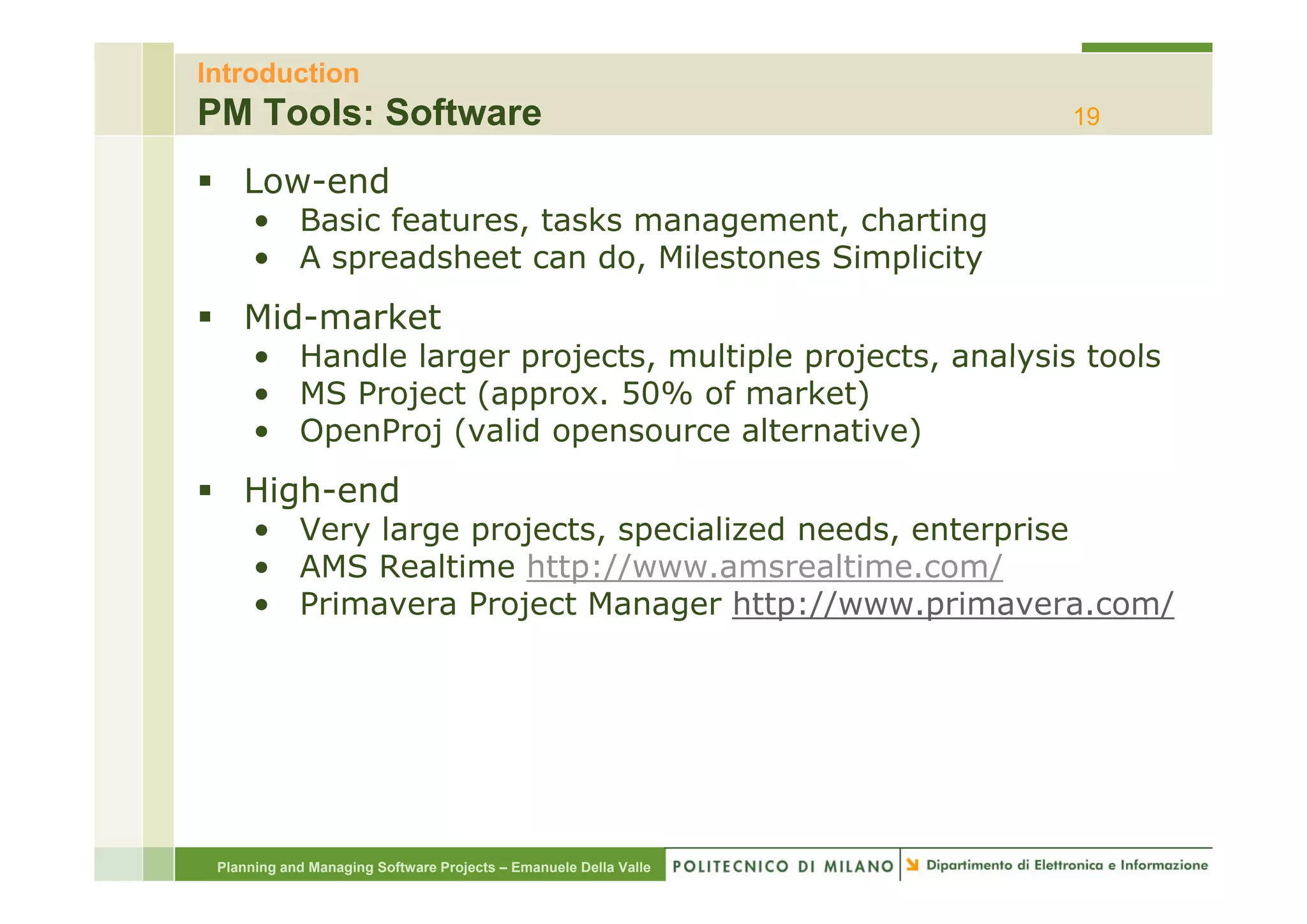

PM Tools: Software                                                19

    Low-end
      • Basic features, tasks management, charting
      • A spreadsheet can do Milestones Simplicity
                            do,
    Mid-market
      • Handle larger projects multiple projects, analysis tools
                      projects,         projects
      • MS Project (approx. 50% of market)
      • OpenProj (valid opensource alternative)
    High-end
      • Very large projects, specialized needs, enterprise
      • AMS Realtime http://www amsrealtime com/
                      http://www.amsrealtime.com/
      • Primavera Project Manager http://www.primavera.com/




 Planning and Managing Software Projects – Emanuele Della Valle
Introduction

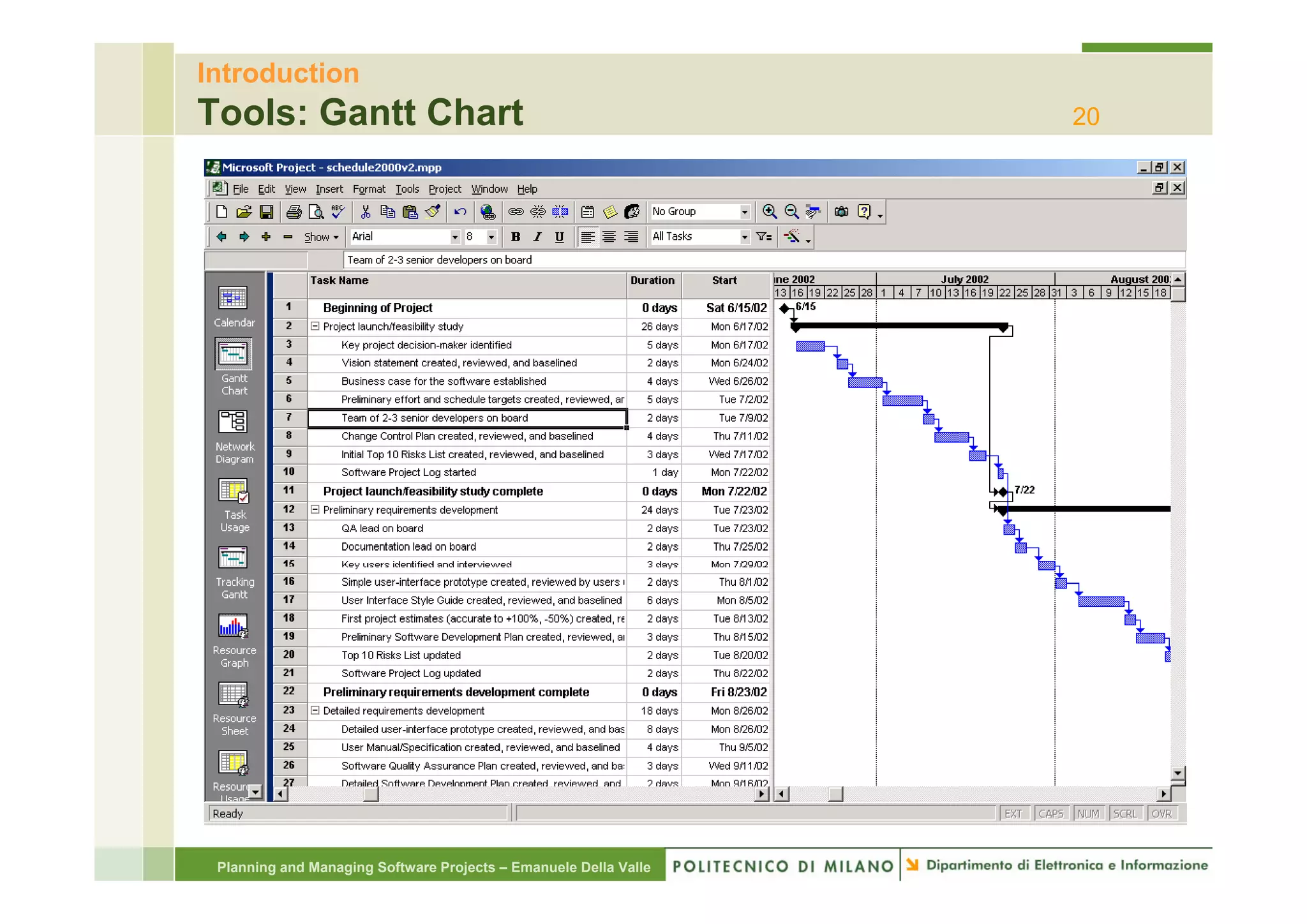

Tools: Gantt Chart                                                20




 Planning and Managing Software Projects – Emanuele Della Valle

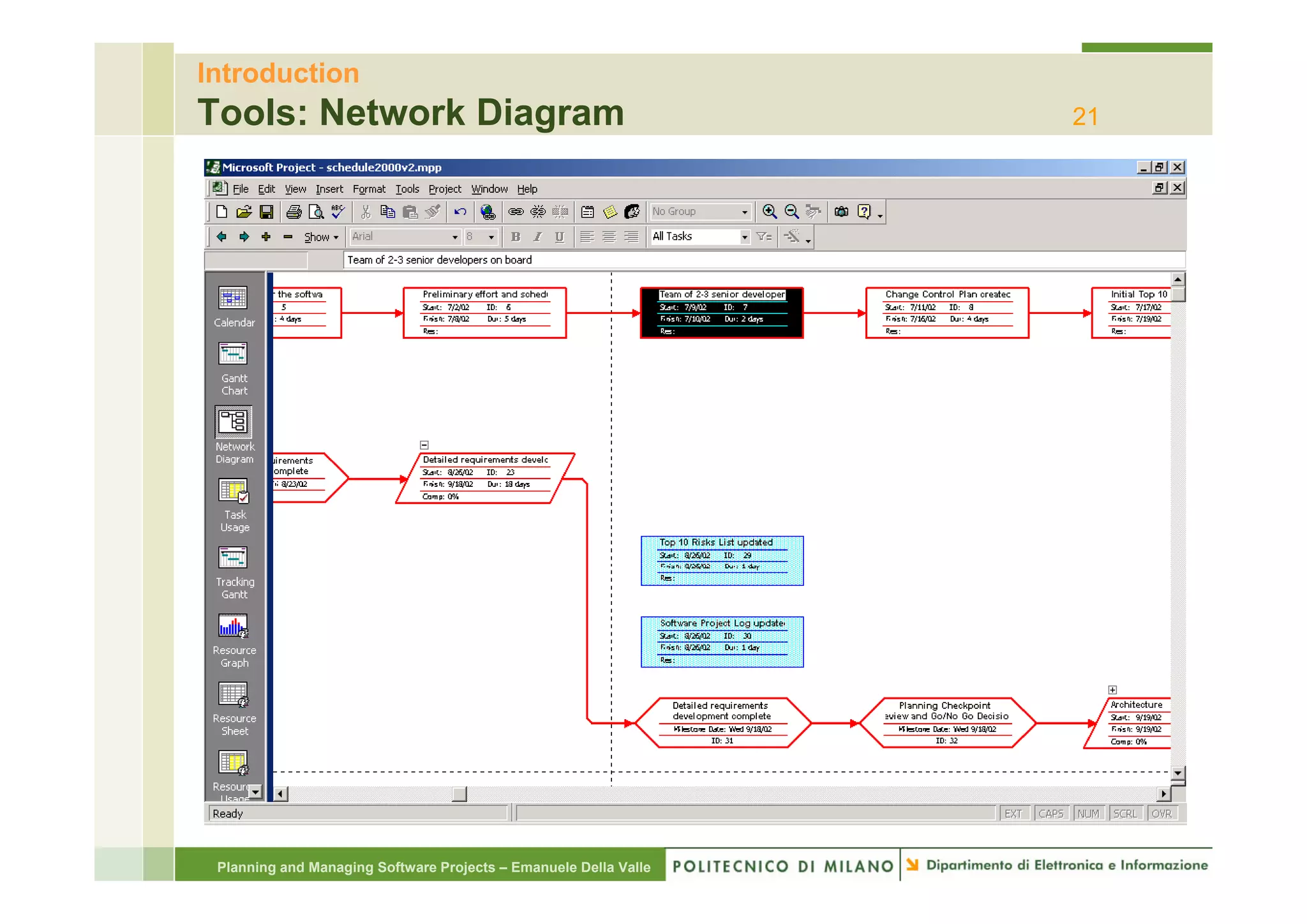

Introduction
Tools: Network Diagram                                            21




 Planning and Managing Software Projects – Emanuele Della Valle
Fundamentals
PMI’s 9 Knowledge Areas                                           22

    Project integration management
    Scope
    Time
    Cost
    C t
    Quality
    Human resource
    Communications
    Risk
    Procurement




 Planning and Managing Software Projects – Emanuele Della Valle
Fundamentals
First Principles                                                  23

    One size does not fit all!
    Patterns and Anti-Patterns (see Classic Mistakes later)
                 Anti Patterns
    Spectrums
      • Project types
           j     yp
      • Sizes
      • Formality and rigor


    Project are like families, each dysfunctional in it’s own
    “special way”
     special way




 Planning and Managing Software Projects – Emanuele Della Valle
Fundamentals
Our Pattern: Rapid Development                                    24

    Faster delivery
    Reduced risk
    Increased visibility to customer
    Don’t f
    D ’t forsake quality
              k     lit




 Planning and Managing Software Projects – Emanuele Della Valle
Fundamentals
Rapid Development Strategy                                        25

    Classic Mistake Avoidance
    Development Fundamentals
    Risk Management
    Schedule-Oriented Practices
    S h d l O i t dP      ti




 Planning and Managing Software Projects – Emanuele Della Valle
Fundamentals

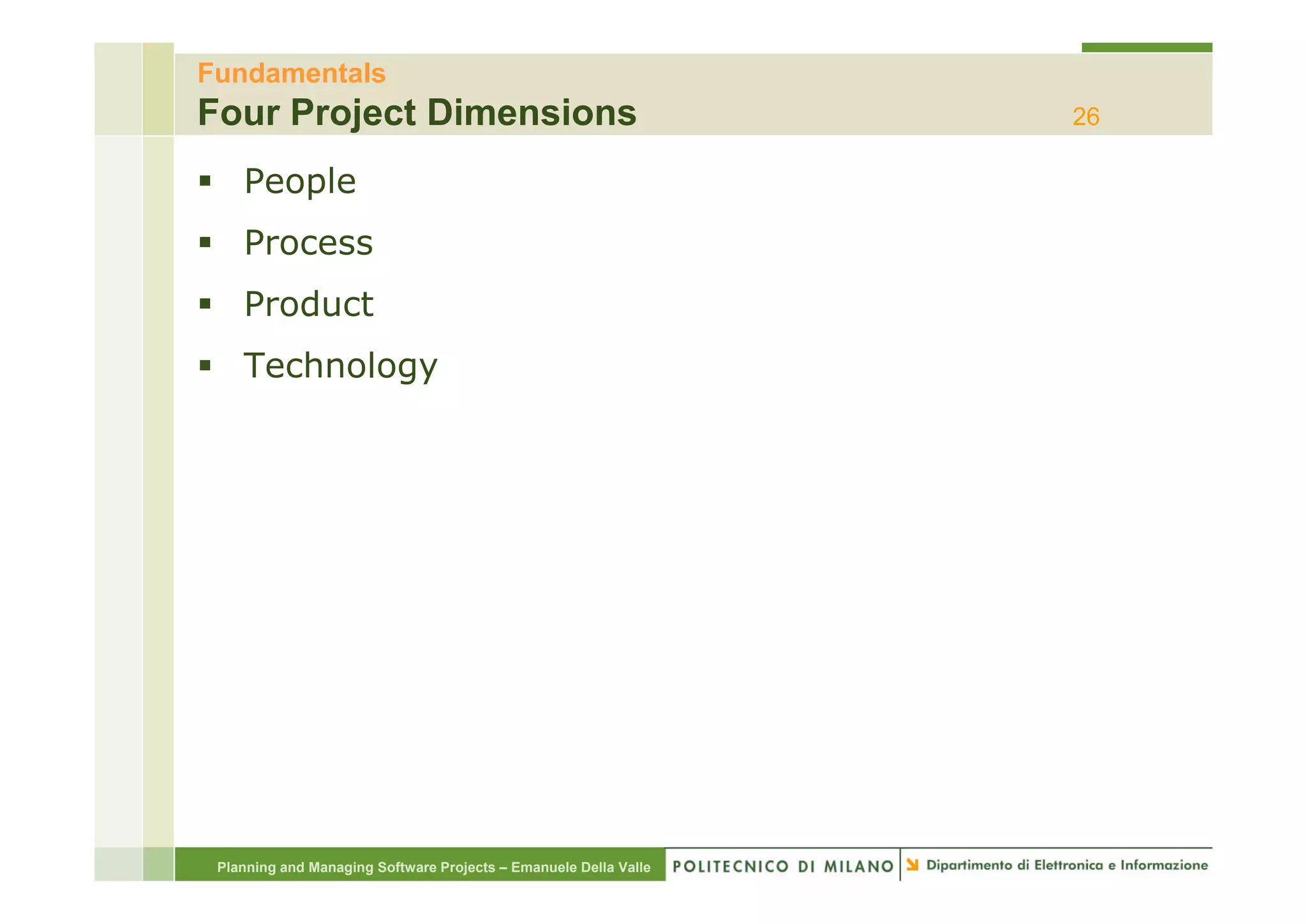

Four Project Dimensions                                           26

    People
    Process
    Product
    Technology
    T h l




 Planning and Managing Software Projects – Emanuele Della Valle
Fundamentals
Trade-off Triangle                                                27

    Fast, cheap, good. Choose two.




 Planning and Managing Software Projects – Emanuele Della Valle
Fundamentals

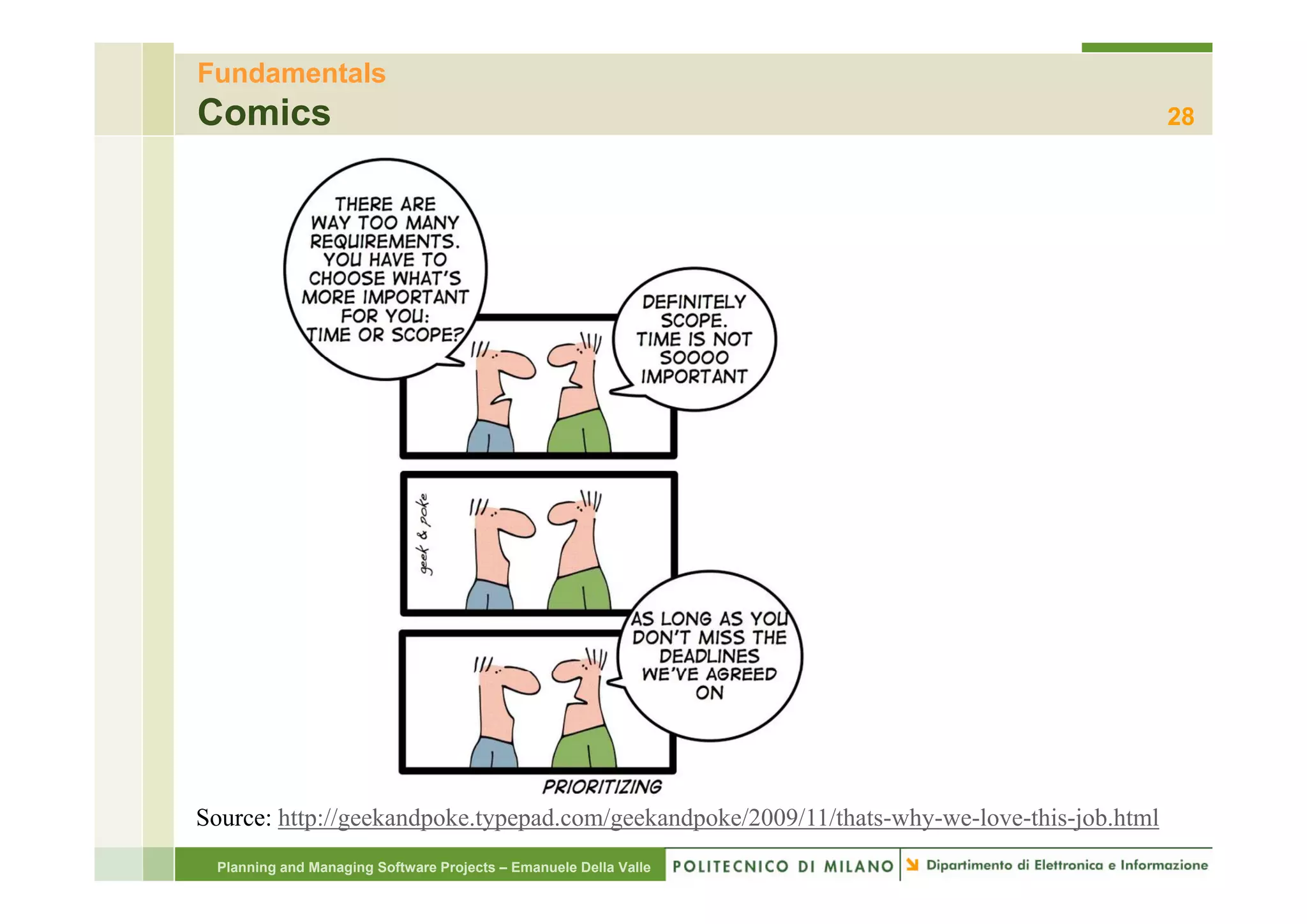

Comics                                                                                       28




Source: http://geekandpoke.typepad.com/geekandpoke/2009/11/thats-why-we-love-this-job.html
 Planning and Managing Software Projects – Emanuele Della Valle
Fundamentals

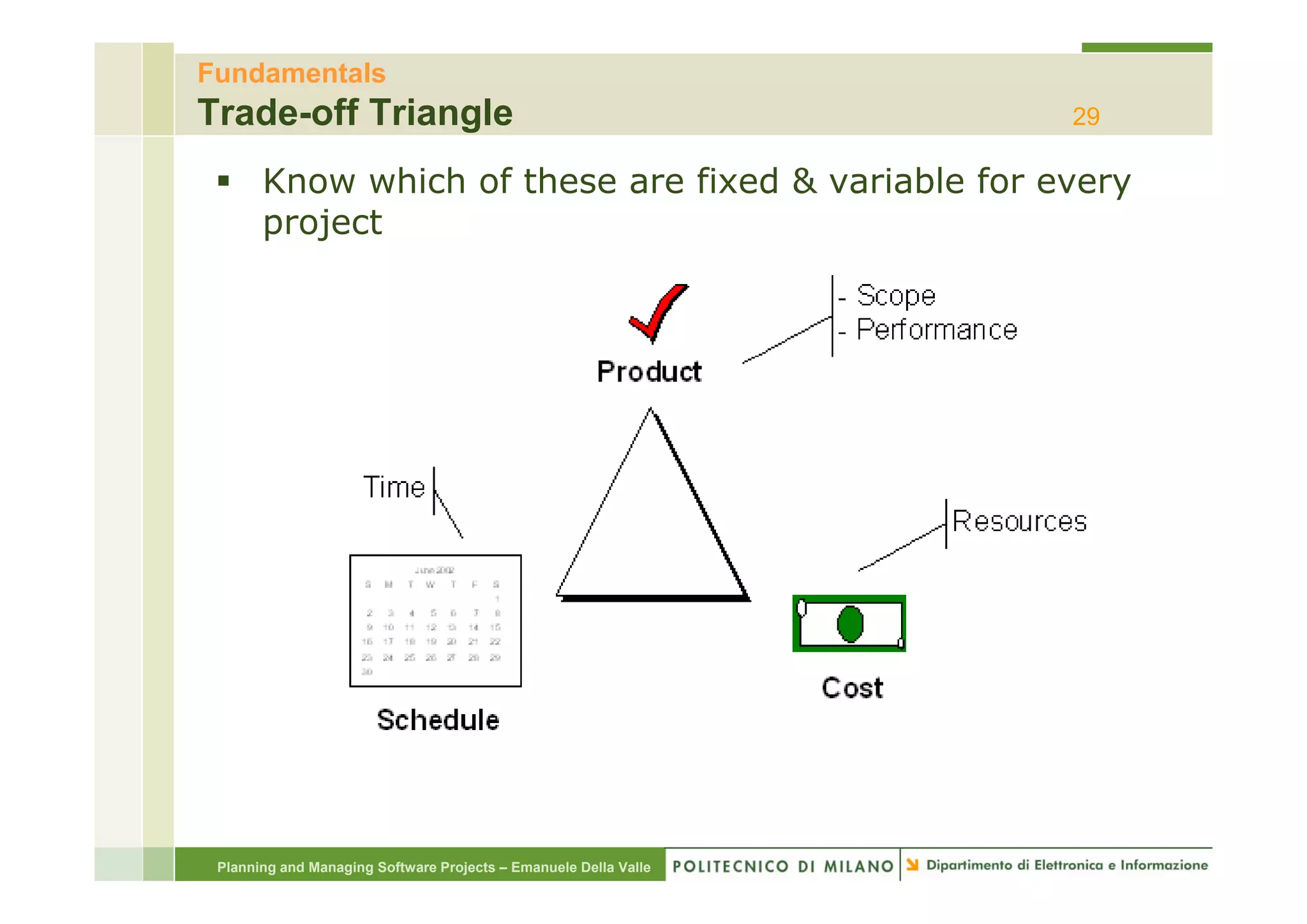

Trade-off Triangle                                                29

       Know which of these are fixed & variable for every
       project




 Planning and Managing Software Projects – Emanuele Della Valle
Fundamentals – Four Dimensions

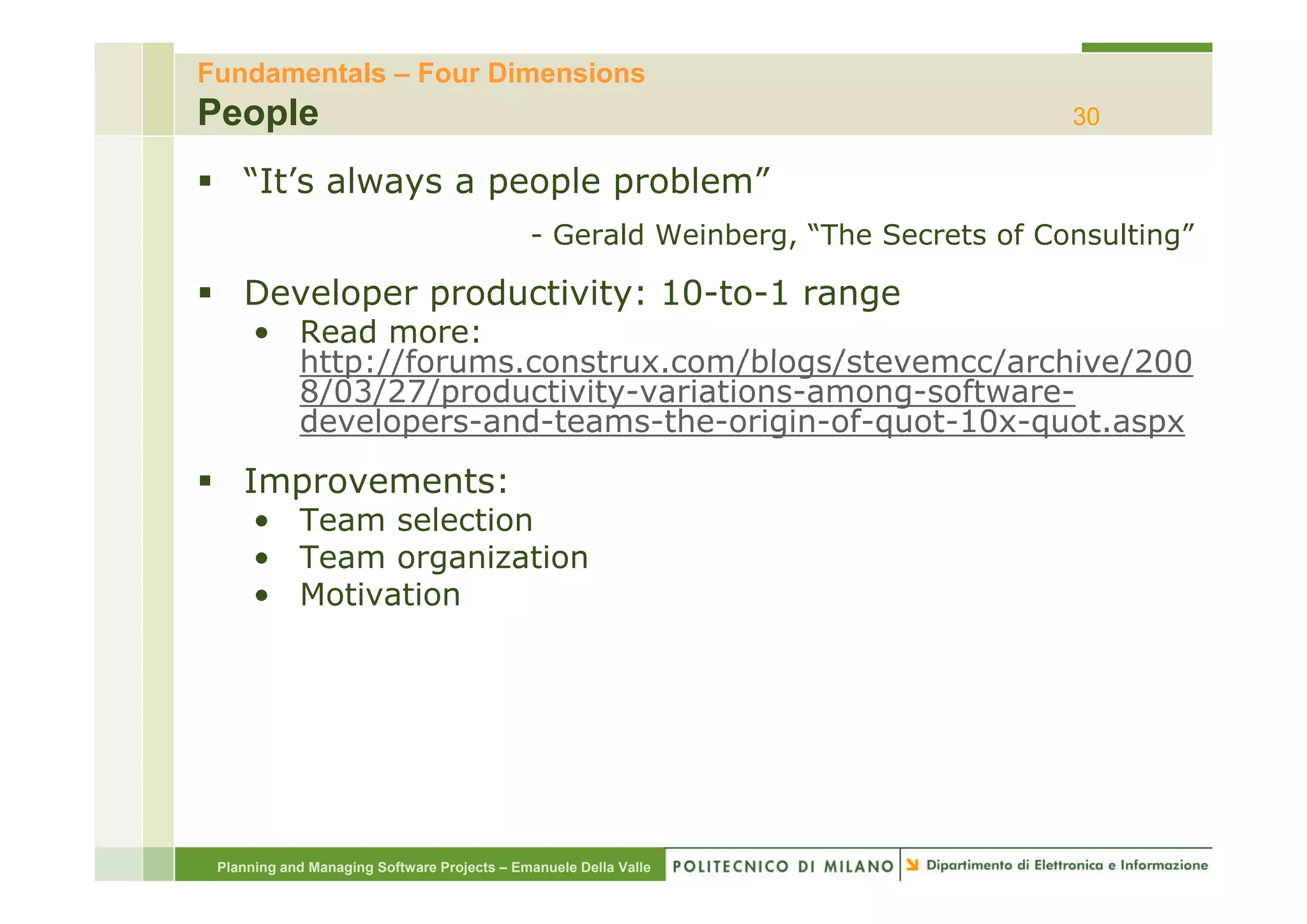

People                                                                            30

    “It’s always a people problem”
                                             - Gerald Weinberg, “The Secrets of Consulting”

    Developer productivity: 10-to-1 range
      • Read more:
        http://forums.construx.com/blogs/stevemcc/archive/200
        http://forums construx com/blogs/stevemcc/archive/200
        8/03/27/productivity-variations-among-software-
        developers-and-teams-the-origin-of-quot-10x-quot.aspx
    Improvements:
      • Team selection
      • Team organization
      • Motivation




 Planning and Managing Software Projects – Emanuele Della Valle
Fundamentals – Four Dimensions

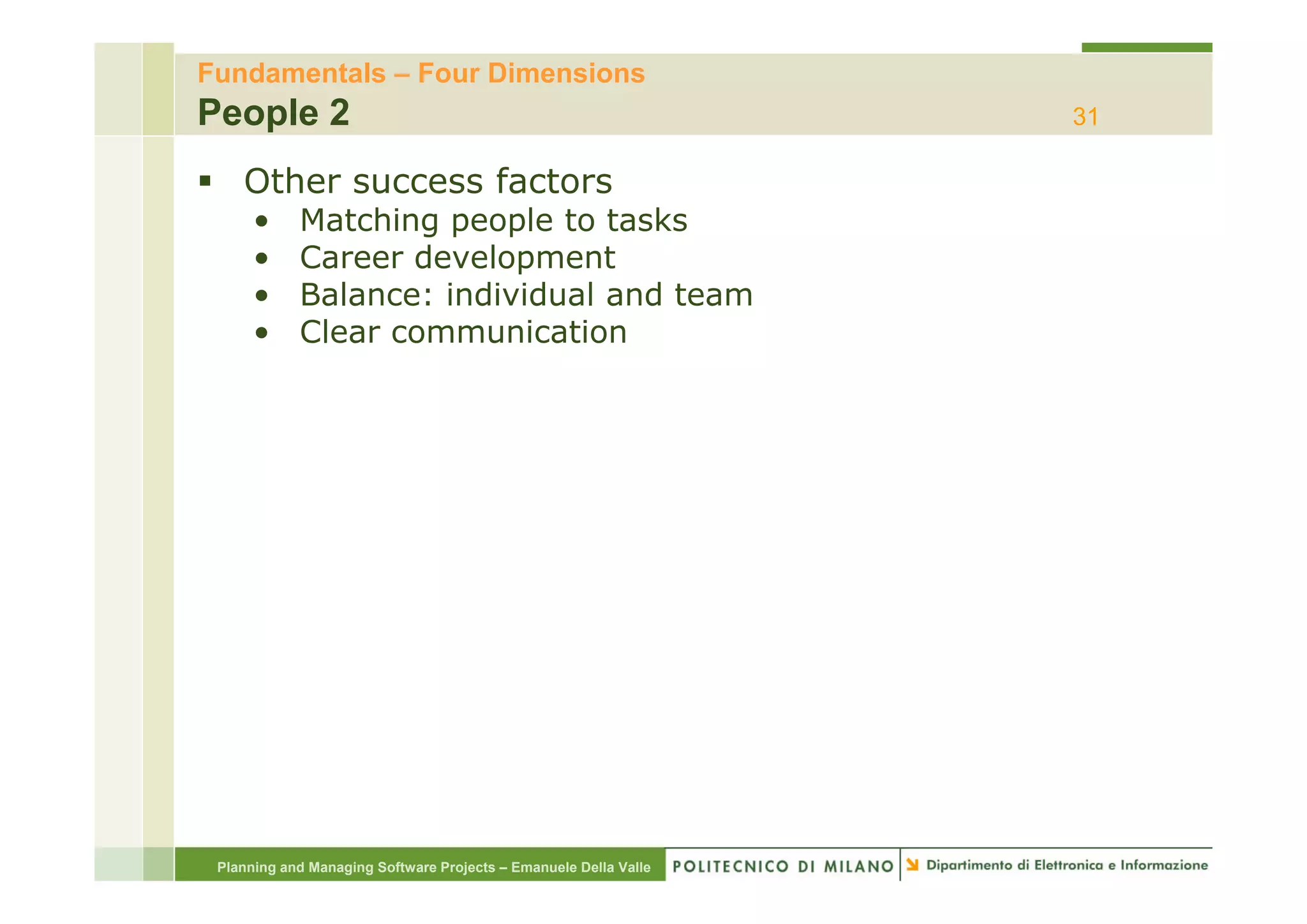

People 2                                                          31

    Other success factors
      •     Matching people to tasks
      •     Career development
      •     Balance: individual and team
      •     Clear communication




 Planning and Managing Software Projects – Emanuele Della Valle
Fundamentals – Four Dimensions

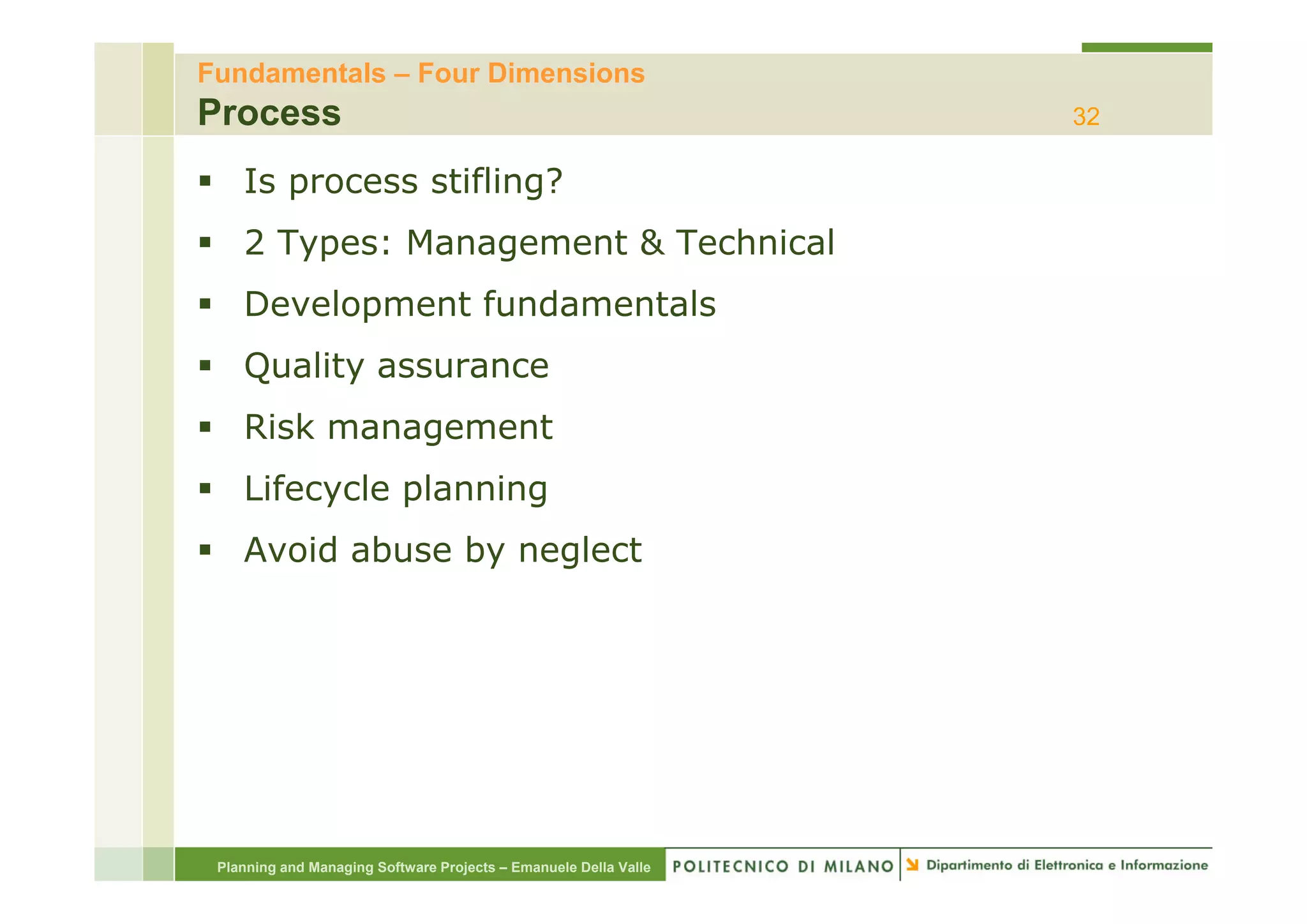

Process                                                           32

    Is process stifling?
    2 Types: Management & Technical
    Development fundamentals
    Quality
    Q lit assurance
    Risk management
    Lifecycle planning
    Avoid abuse by neglect
                 y   g




 Planning and Managing Software Projects – Emanuele Della Valle
Fundamentals – Four Dimensions

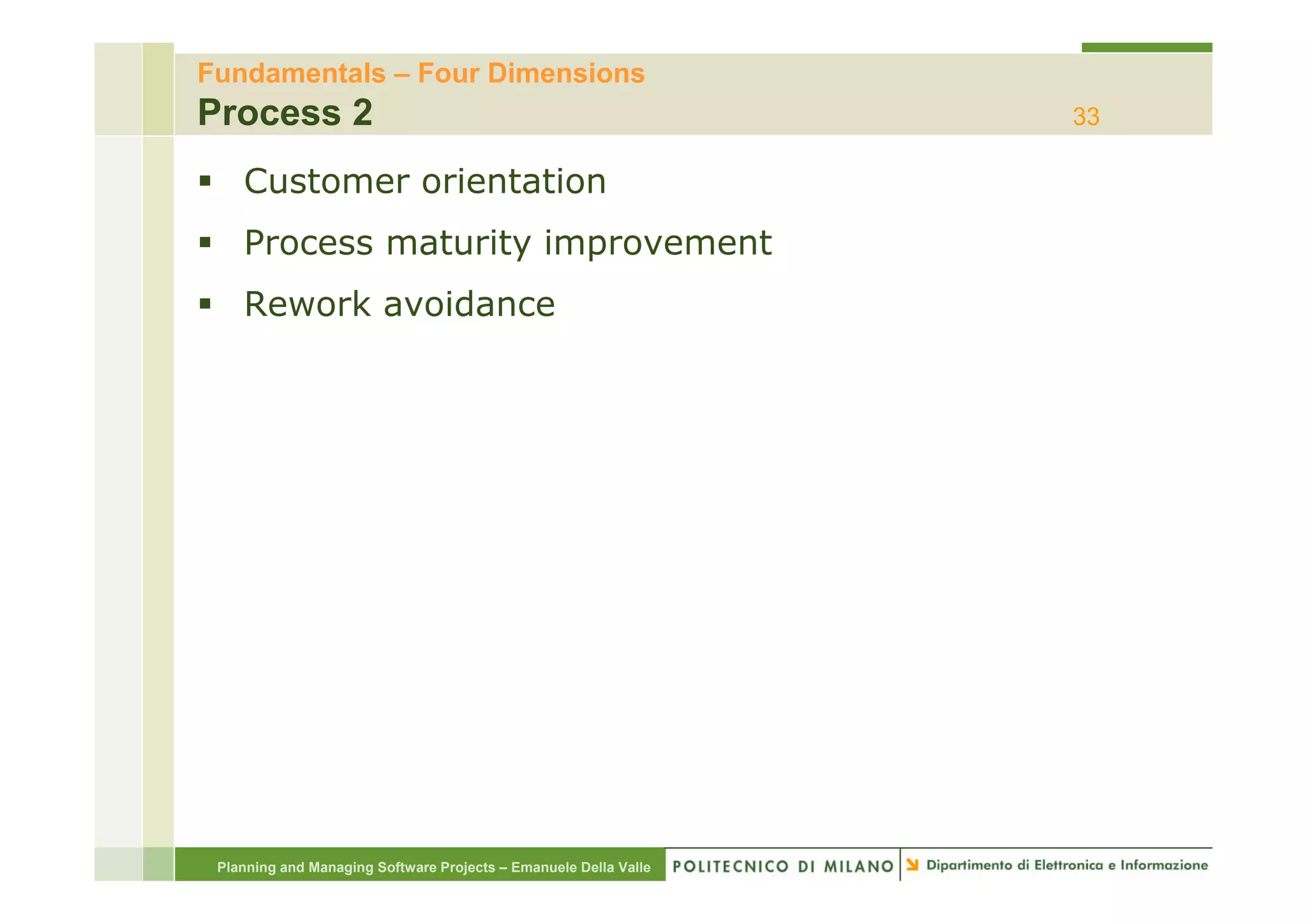

Process 2                                                         33

    Customer orientation
    Process maturity improvement
    Rework avoidance




 Planning and Managing Software Projects – Emanuele Della Valle
Fundamentals – Four Dimensions

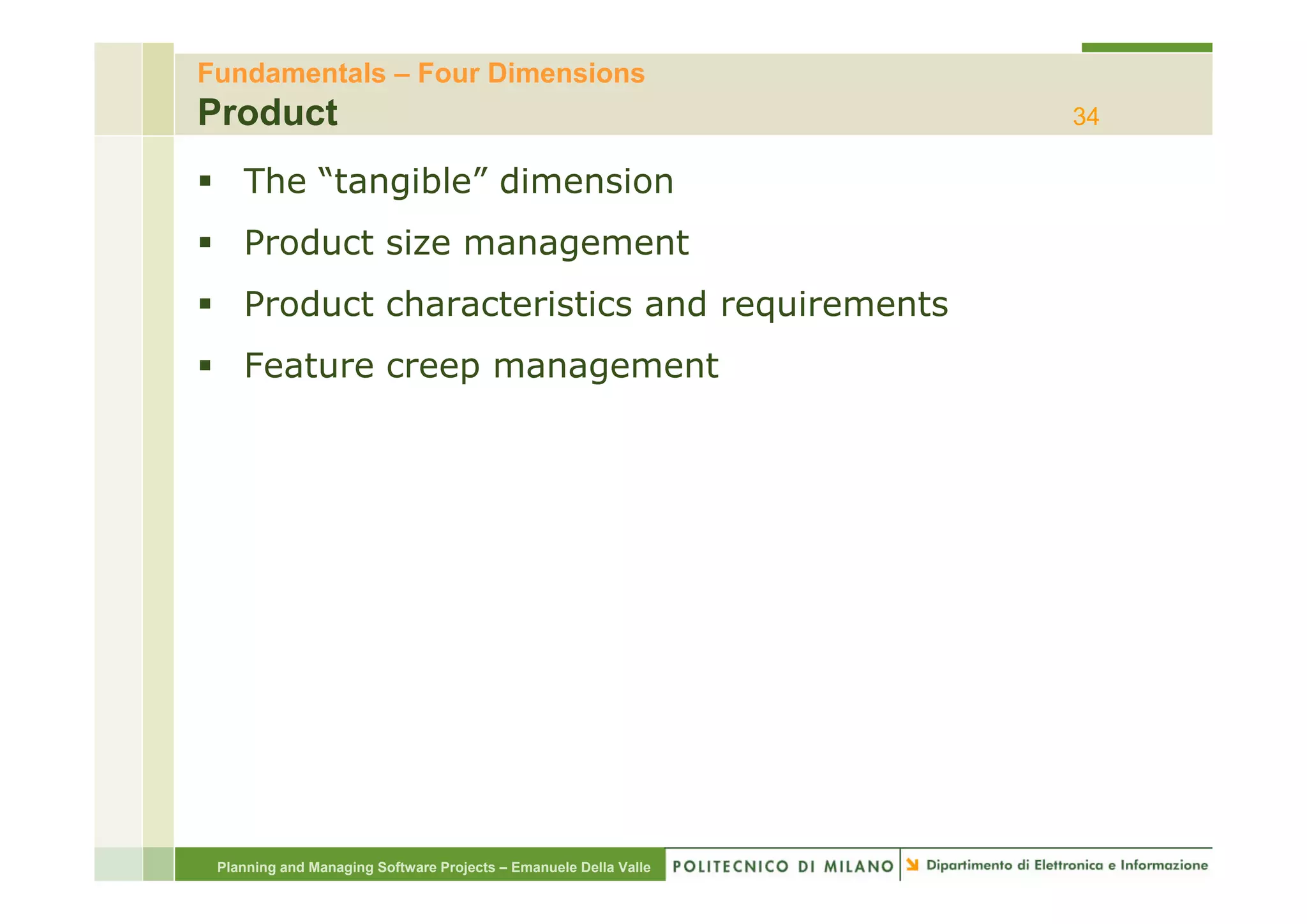

Product                                                           34

    The “tangible” dimension
    Product size management
    Product characteristics and requirements
    Feature creep management
    F t                    t




 Planning and Managing Software Projects – Emanuele Della Valle
Fundamentals – Four Dimensions

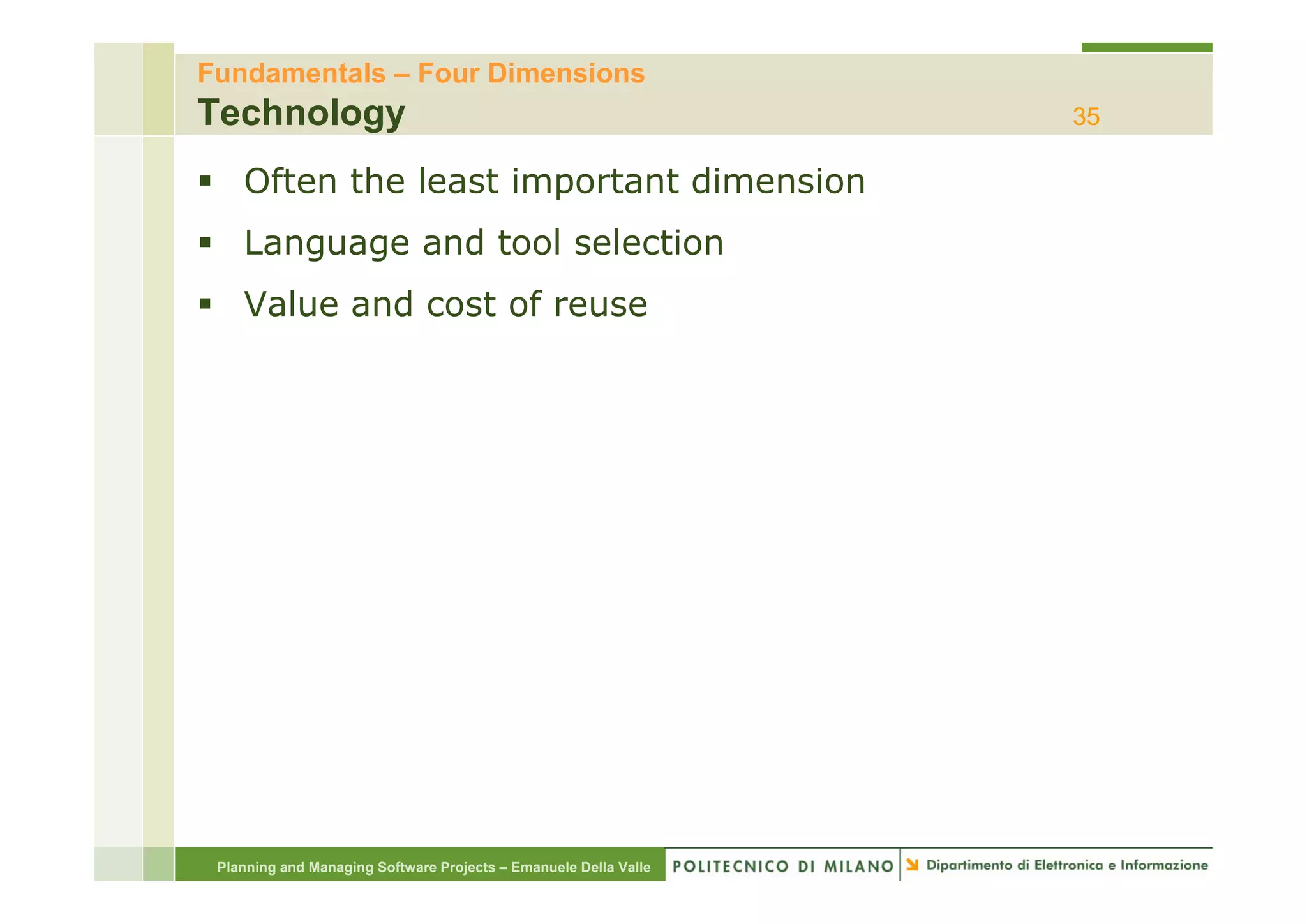

Technology                                                        35

    Often the least important dimension
    Language and tool selection
    Value and cost of reuse




 Planning and Managing Software Projects – Emanuele Della Valle
Fundamentals
Planning                                                          36

    Determine requirements
    Determine resources
    Select lifecycle model
    Determine product features strategy
    D t   i      d tf t         t t




 Planning and Managing Software Projects – Emanuele Della Valle
Fundamentals

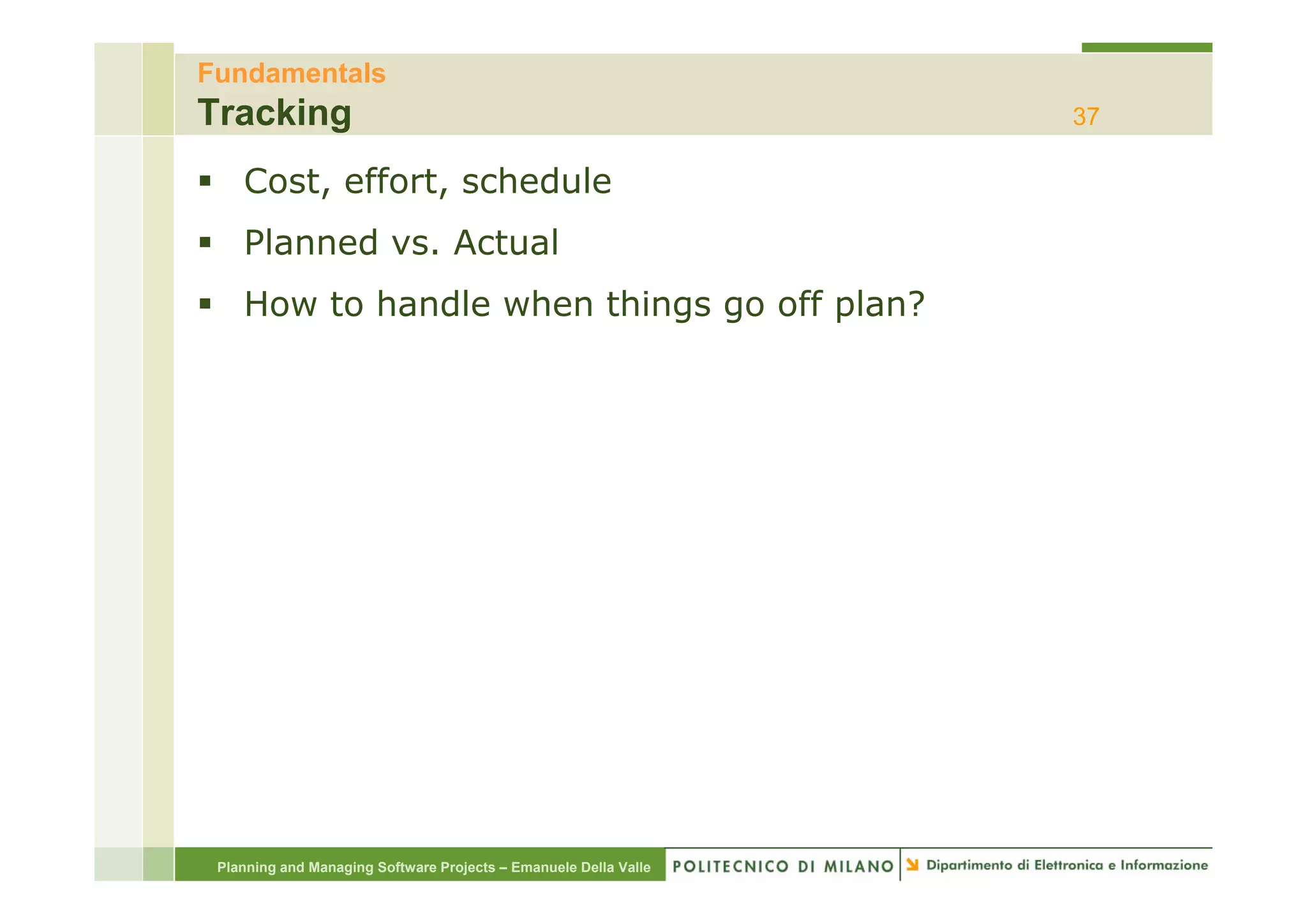

Tracking                                                          37

    Cost, effort, schedule
    Planned vs. Actual
    How to handle when things go off plan?




 Planning and Managing Software Projects – Emanuele Della Valle
Fundamentals

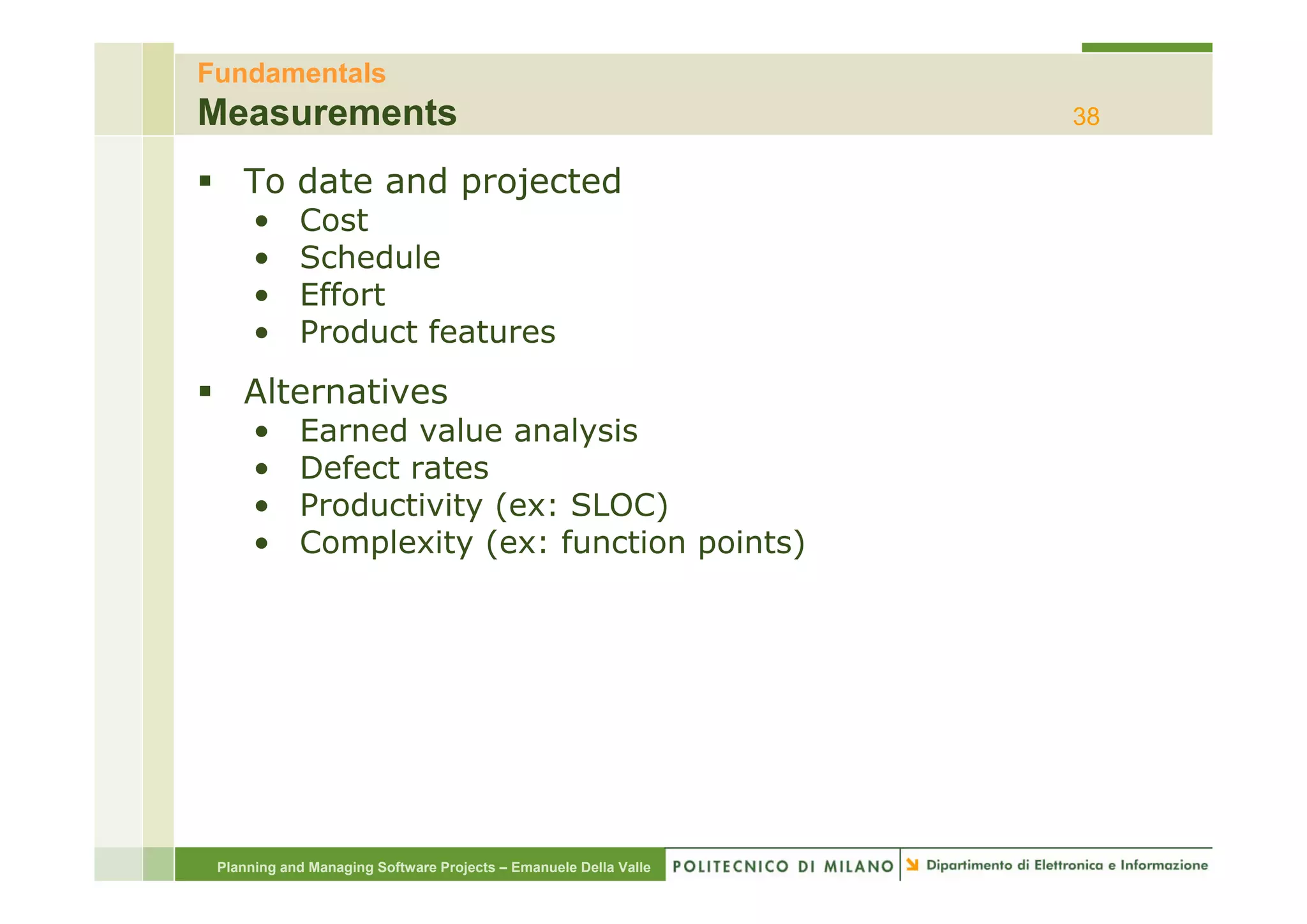

Measurements                                                      38

    To date and projected
      •     Cost
      •     Schedule
      •     Effort
      •     Product features
    Alternatives
      •     Earned value analysis
      •     Defect rates
      •     Productivity (ex: SLOC)
      •     Complexity (ex: function points)




 Planning and Managing Software Projects – Emanuele Della Valle
Fundamentals
Technical Fundamentals                                            39

    Requirements
    Analysis
    Design
    Construction
    C   t   ti
    Quality Assurance
    Deployment




 Planning and Managing Software Projects – Emanuele Della Valle
Fundamentals

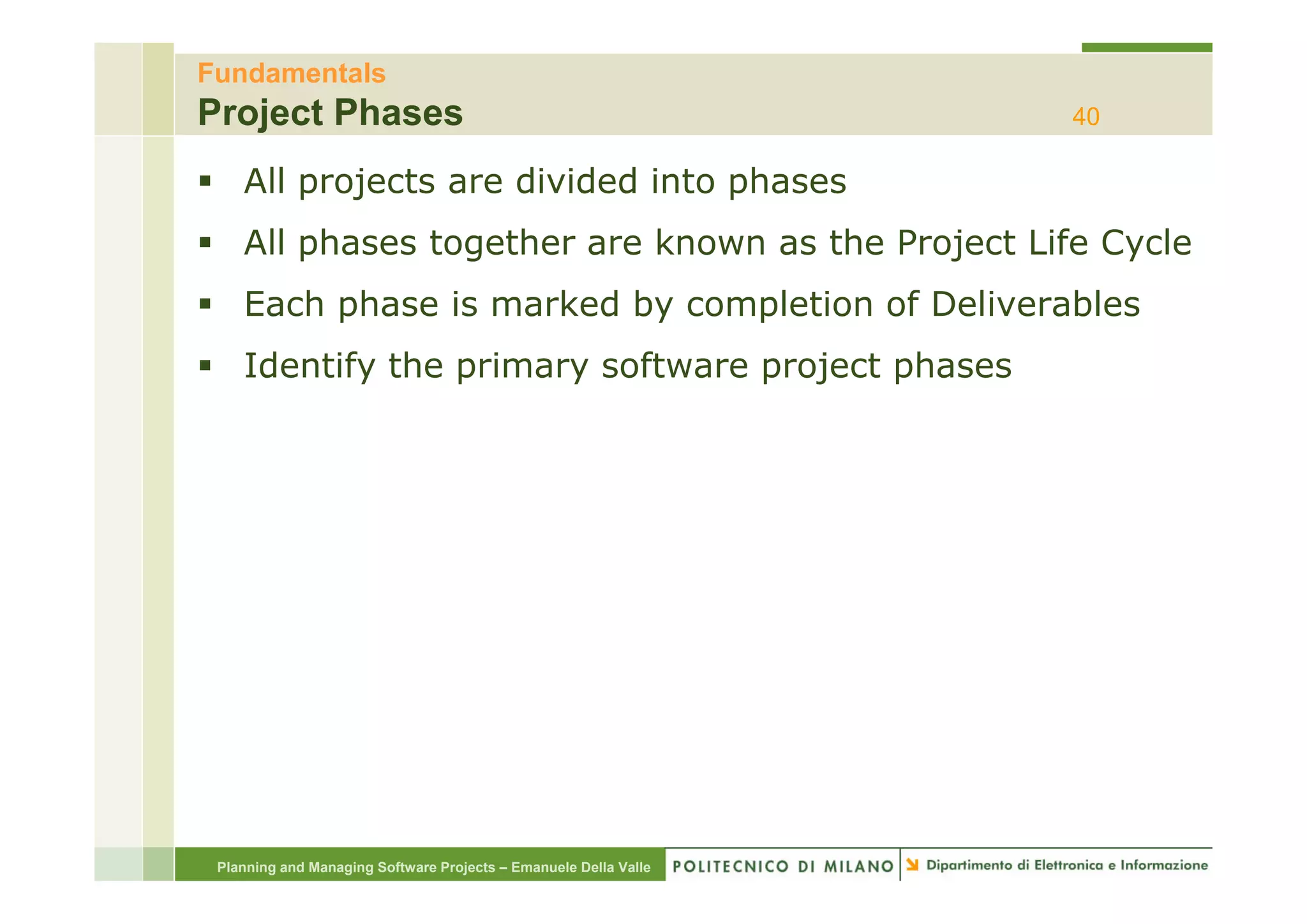

Project Phases                                                    40

    All projects are divided into phases
    All phases together are known as the Project Life Cycle
    Each phase is marked by completion of Deliverables
    Identify th
    Id tif the primary software project phases
                 i       ft        j t h




 Planning and Managing Software Projects – Emanuele Della Valle
Fundamentals

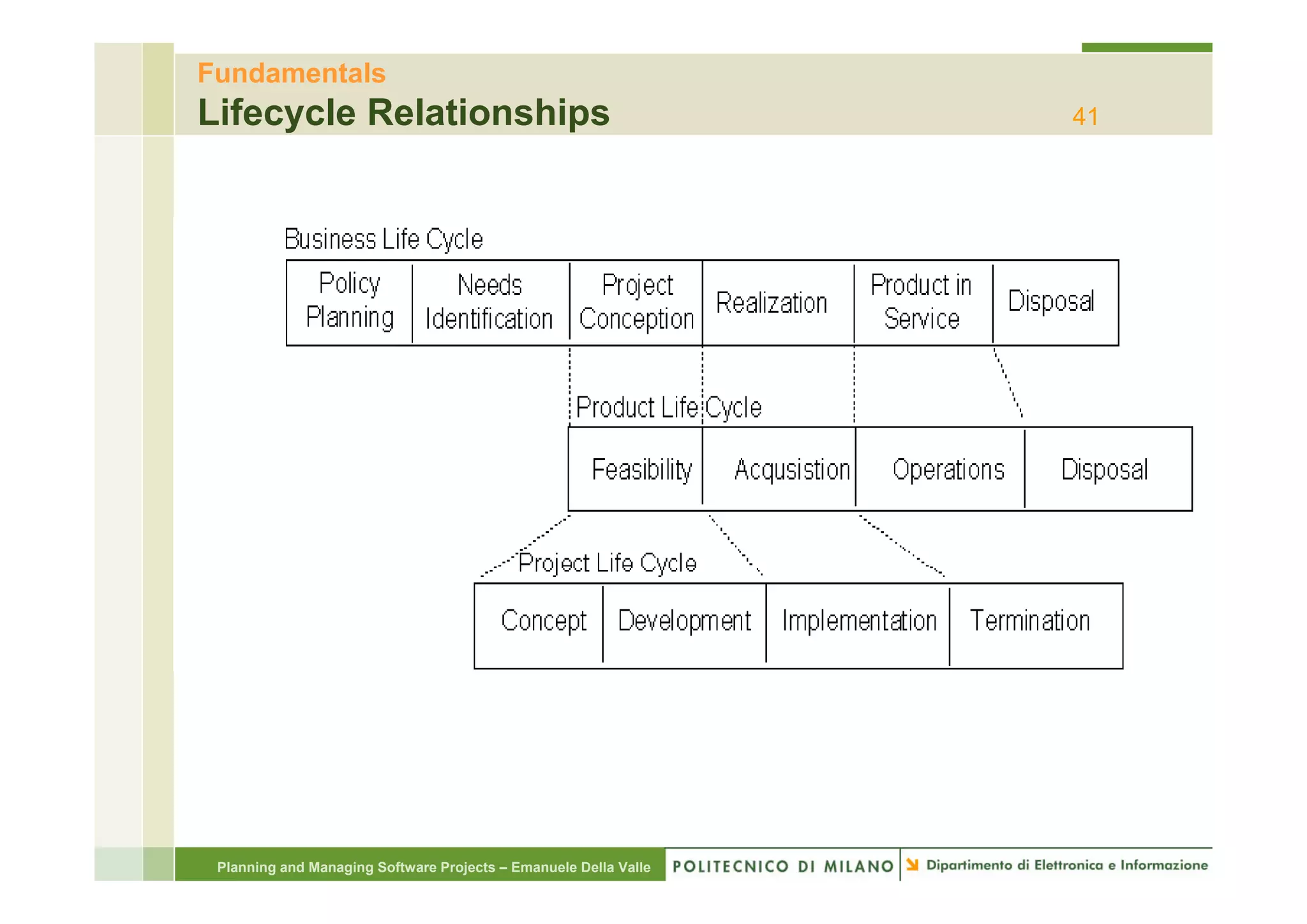

Lifecycle Relationships                                           41




 Planning and Managing Software Projects – Emanuele Della Valle
Fundamentals

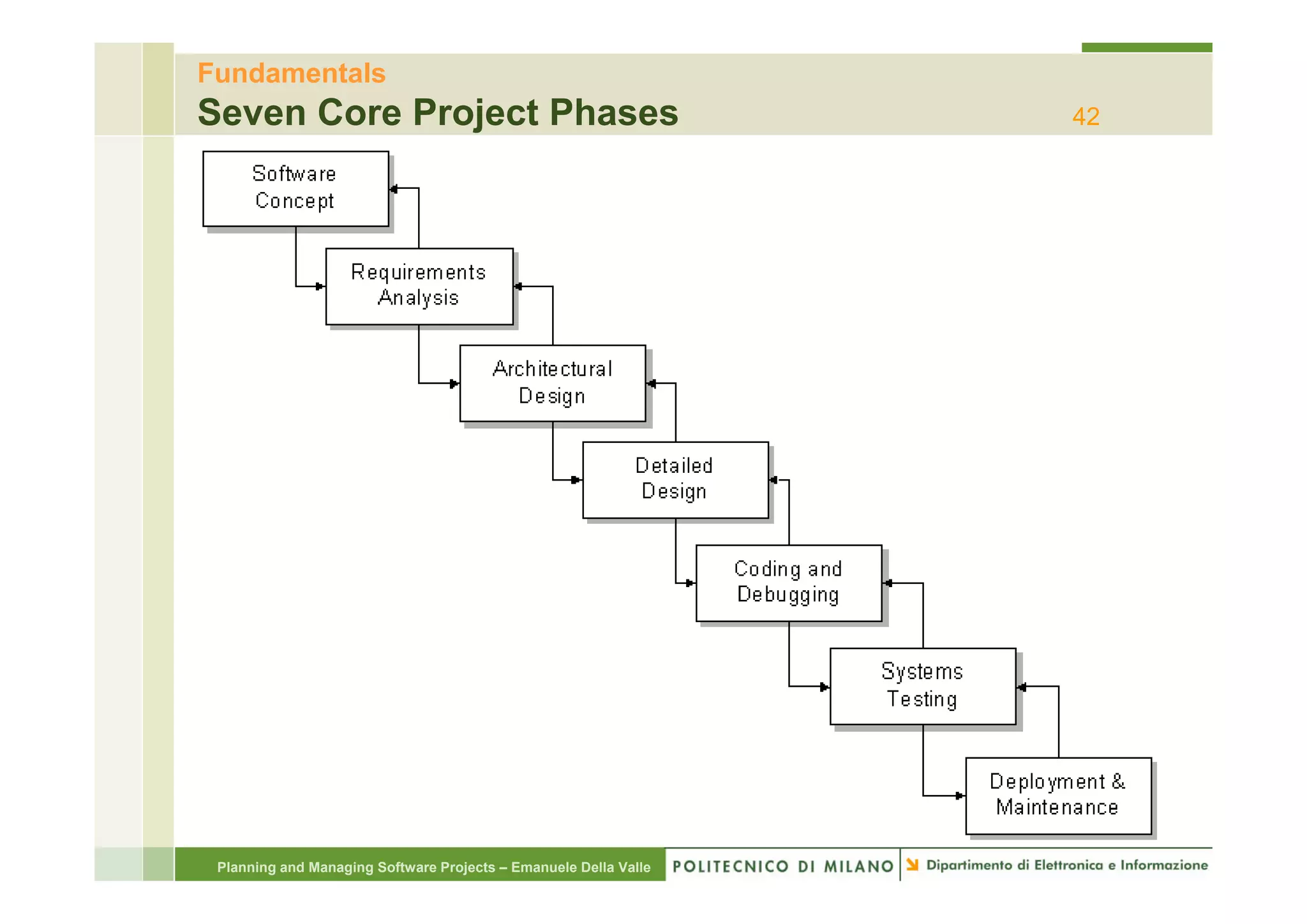

Seven Core Project Phases                                         42




 Planning and Managing Software Projects – Emanuele Della Valle
Fundamentals
Project Phases A.K.A.                                             43




 Planning and Managing Software Projects – Emanuele Della Valle
Fundamentals

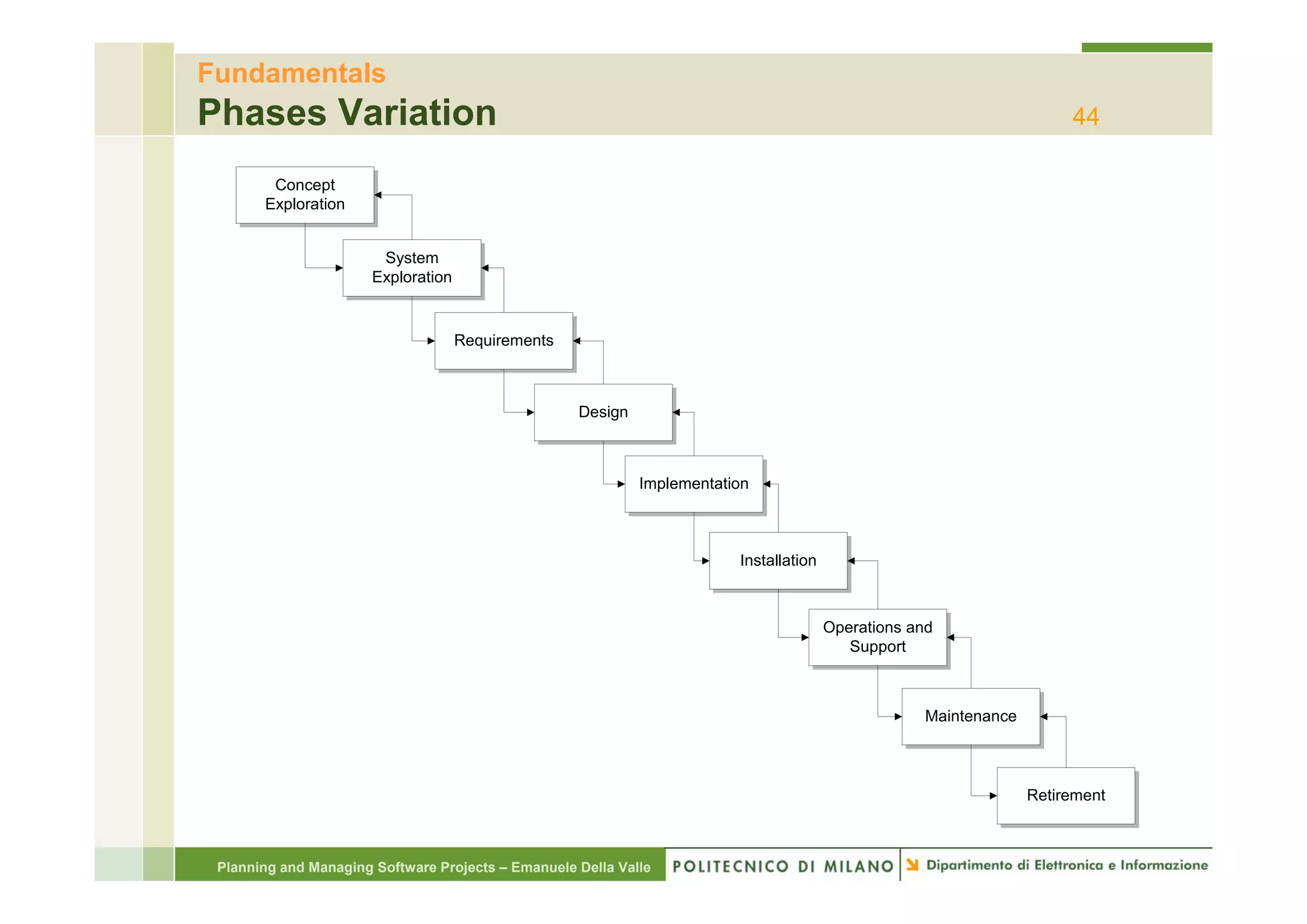

Phases Variation                                                                                                        44

        Concept
       Exploration


                        System
                        S t
                       Exploration


                                     Requirements



                                                    Design



                                                             Implementation



                                                                         Installation



                                                                                        Operations and
                                                                                           Support



                                                                                                     Maintenance



                                                                                                                   Retirement



 Planning and Managing Software Projects – Emanuele Della Valle

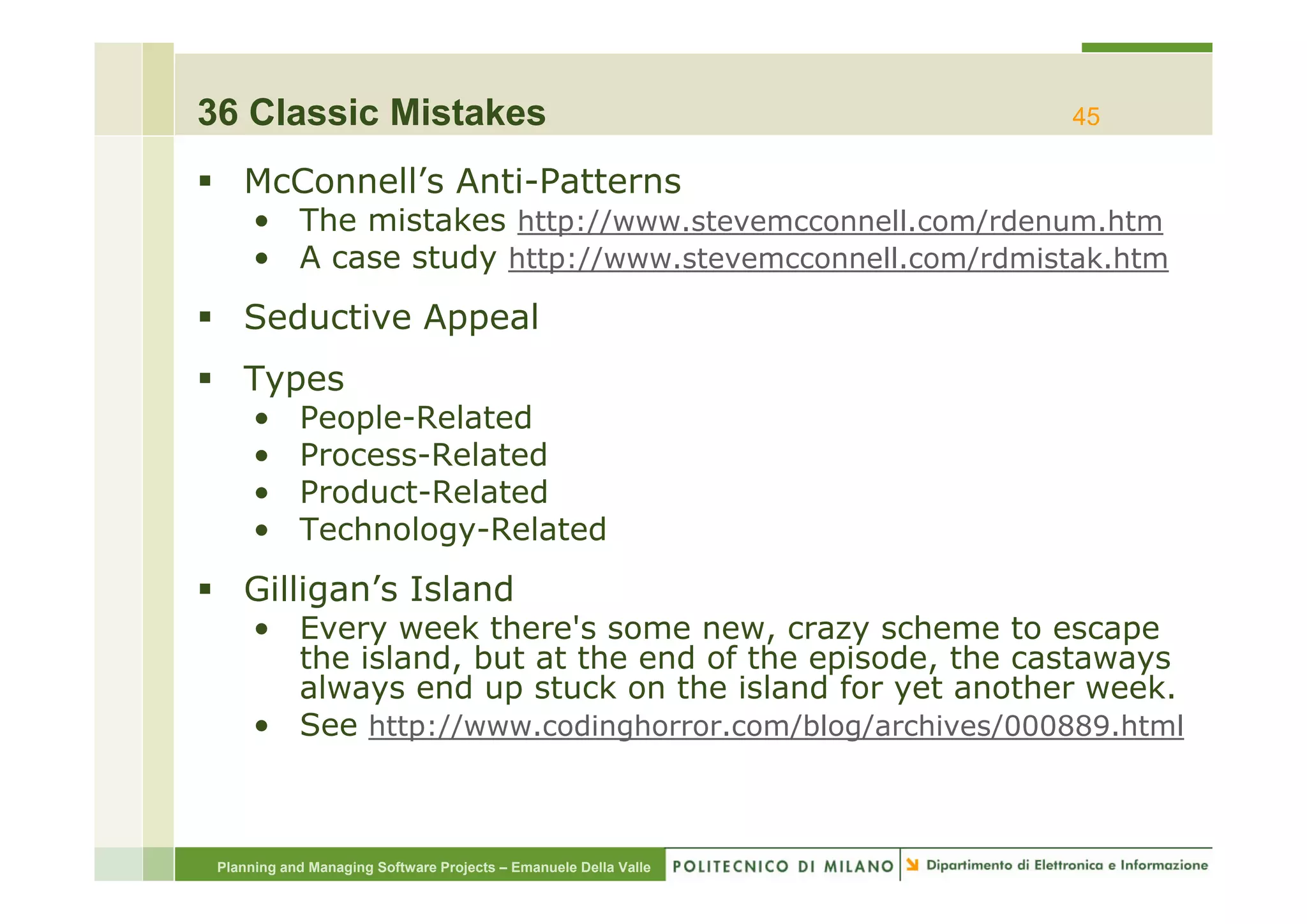

36 Classic Mistakes                                               45

    McConnell’s Anti-Patterns
      • The mistakes http://www.stevemcconnell.com/rdenum.htm
      • A case study htt //
                     http://www.stevemcconnell.com/rdmistak.htm
                                 t          ll    / d i t k ht

    Seductive Appeal
    Types
      •     People-Related
      •     Process Related
            Process-Related
      •     Product-Related
      •     Technology-Related
    Gilligan’s Island
      • Every week there's some new, crazy scheme to escape
        the island, but at the end of the episode, the castaways
                  ,                        p     ,            y
        always end up stuck on the island for yet another week.
      • See http://www.codinghorror.com/blog/archives/000889.html



 Planning and Managing Software Projects – Emanuele Della Valle
Classic Mistakes

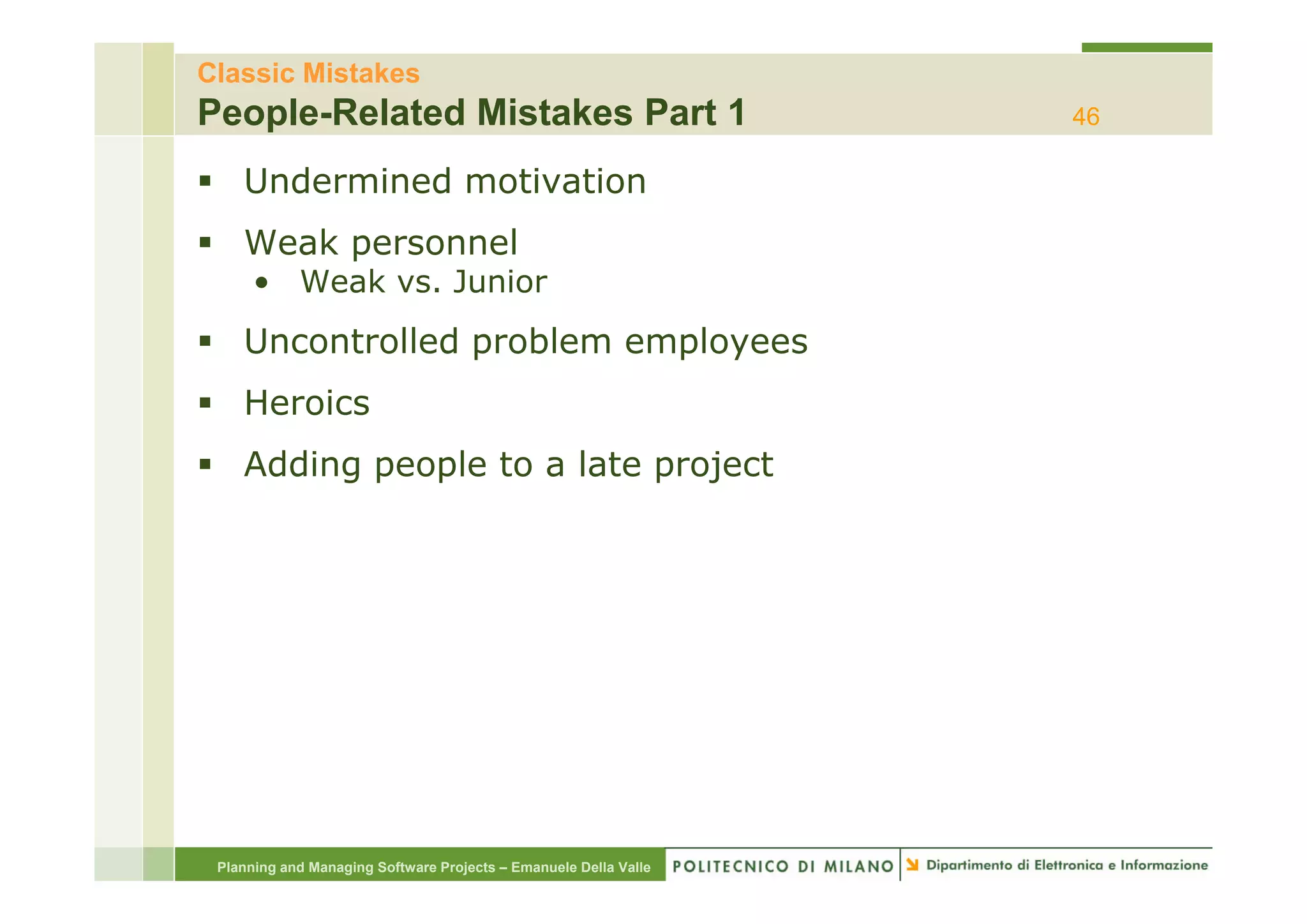

People-Related Mistakes Part 1                                    46

    Undermined motivation
    Weak personnel
      • Weak vs. Junior
    Uncontrolled problem employees
                 p         p y
    Heroics
    Adding people to a late project




 Planning and Managing Software Projects – Emanuele Della Valle
Classic Mistakes

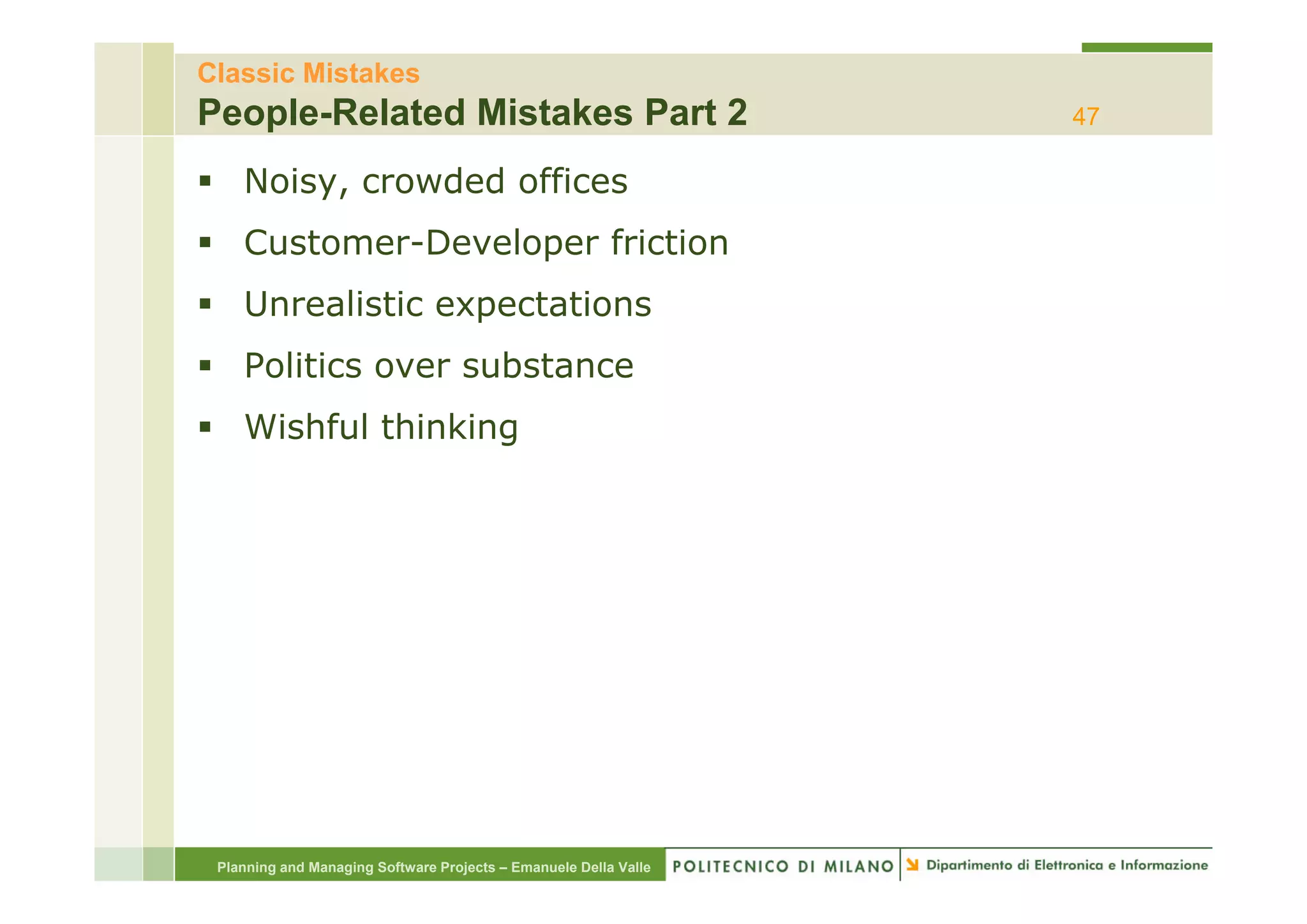

People-Related Mistakes Part 2                                    47

    Noisy, crowded offices
    Customer Developer
    Customer-Developer friction
    Unrealistic expectations
    Politics
    P liti over substance
                  b t
    Wishful thinking




 Planning and Managing Software Projects – Emanuele Della Valle
Classic Mistakes

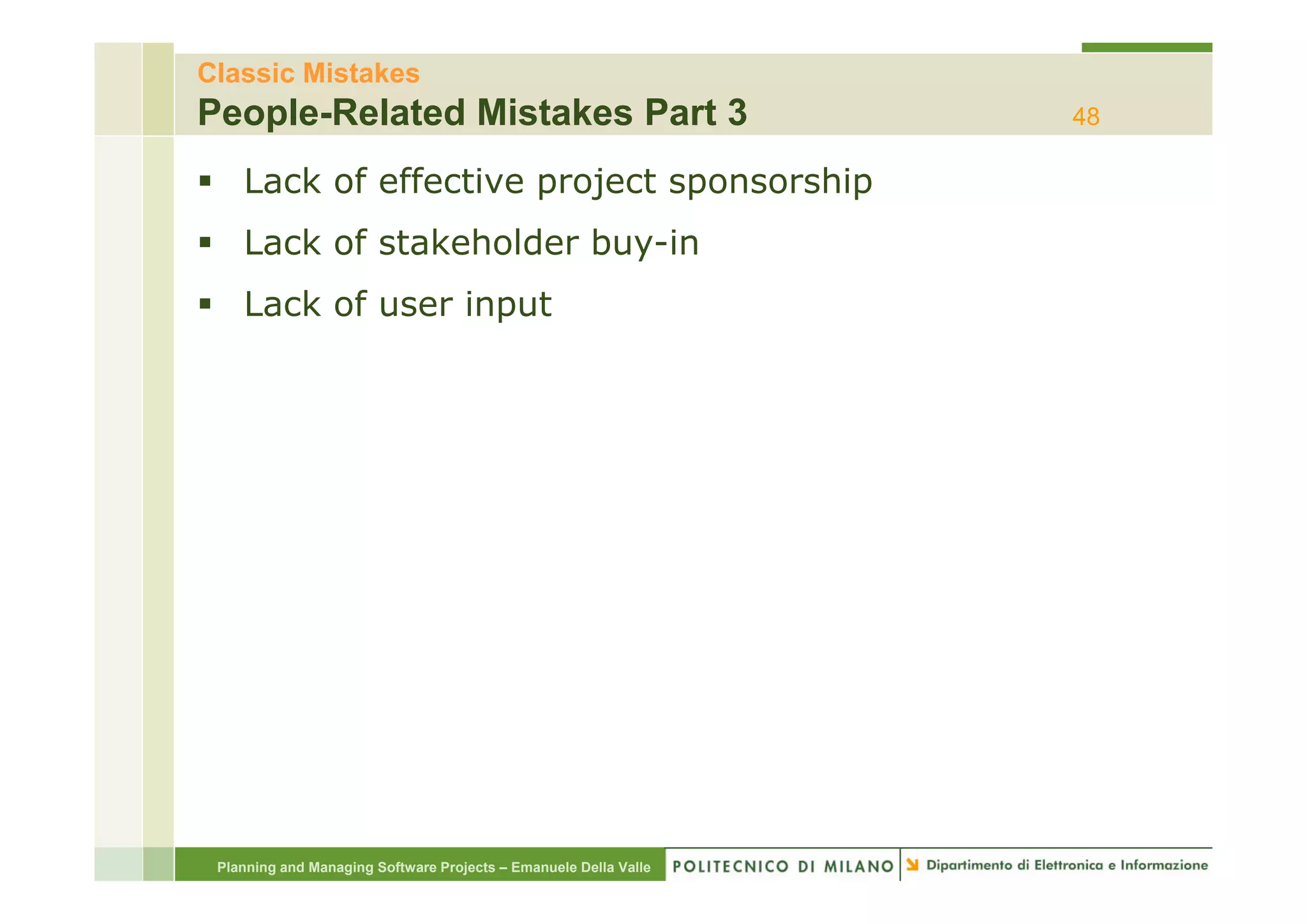

People-Related Mistakes Part 3                                    48

    Lack of effective project sponsorship
    Lack of stakeholder buy-in
                        buy in
    Lack of user input




 Planning and Managing Software Projects – Emanuele Della Valle
Classic Mistakes

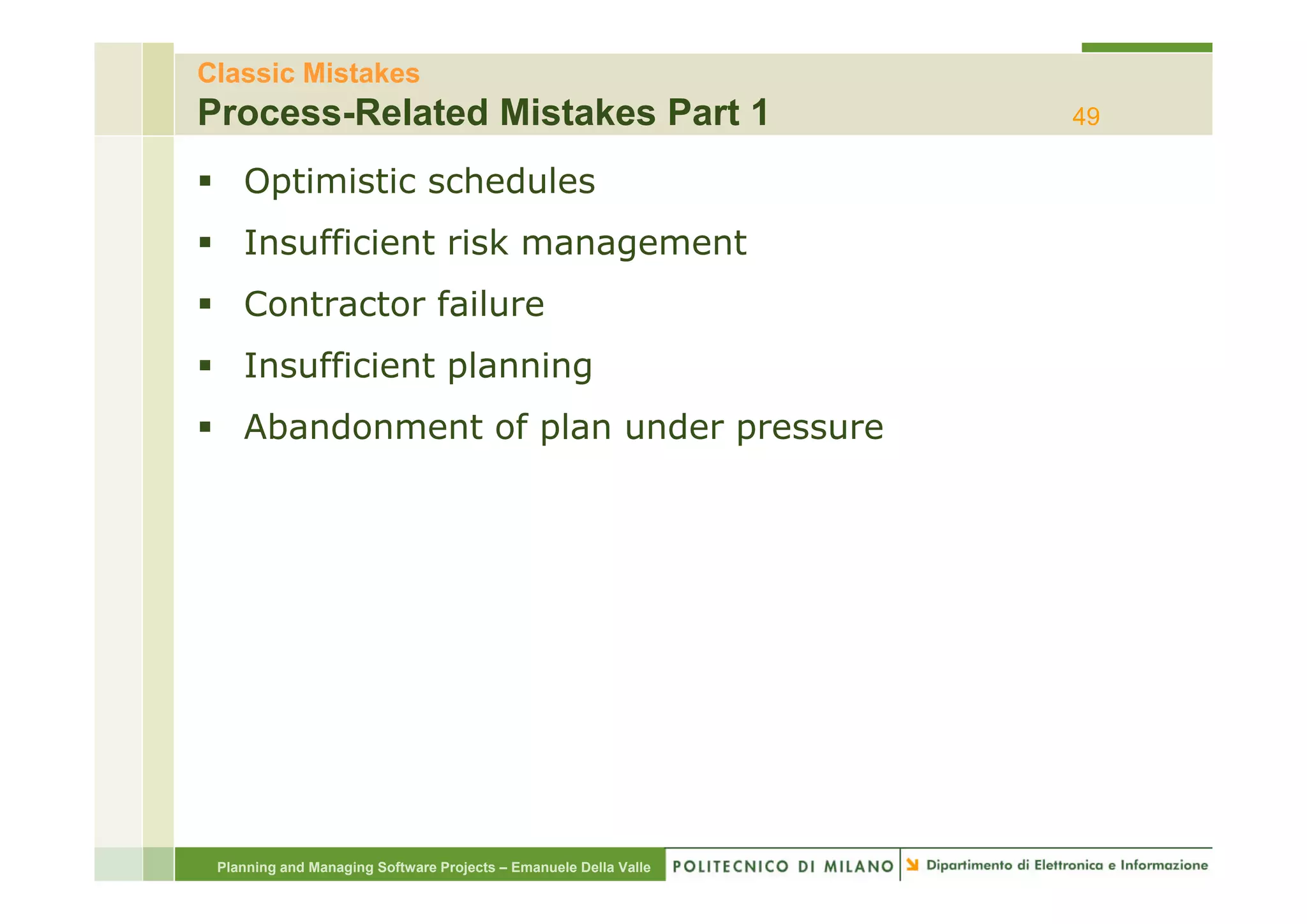

Process-Related Mistakes Part 1                                   49

    Optimistic schedules
    Insufficient risk management
    Contractor failure
    Insufficient planning
    I   ffi i t l     i
    Abandonment of plan under pressure




 Planning and Managing Software Projects – Emanuele Della Valle
Classic Mistakes

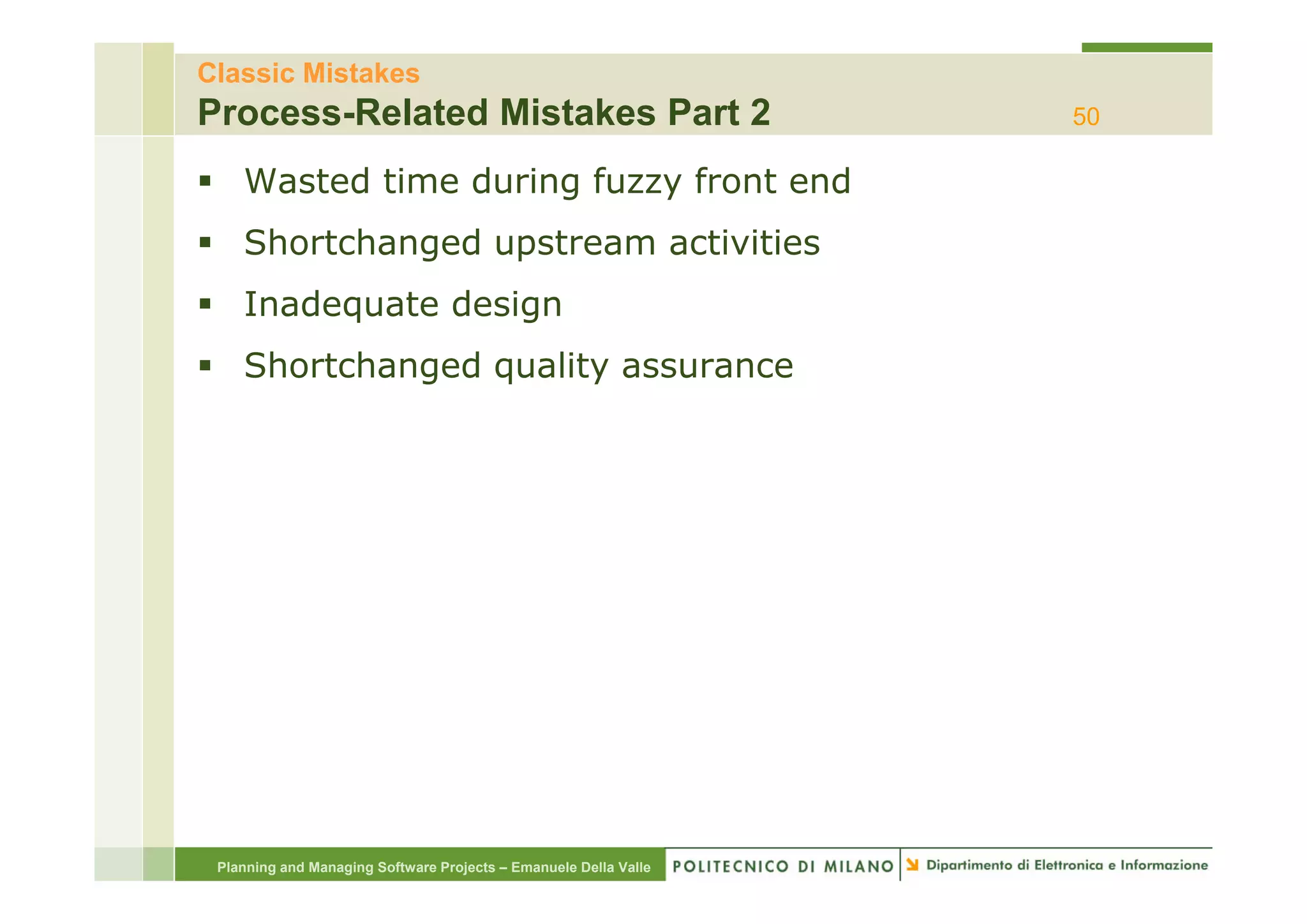

Process-Related Mistakes Part 2                                   50

    Wasted time during fuzzy front end
    Shortchanged upstream activities
    Inadequate design
    Shortchanged quality assurance
    Sh t h     d    lit




 Planning and Managing Software Projects – Emanuele Della Valle
Classic Mistakes
Process-Related Mistakes Part 3                                   51

    Insufficient management controls
    Frequent convergence
    Omitting necessary tasks from estimates
    Planning t catch-up l t
    Pl   i   to t h     later
    Code-like-hell programming




 Planning and Managing Software Projects – Emanuele Della Valle
Classic Mistakes

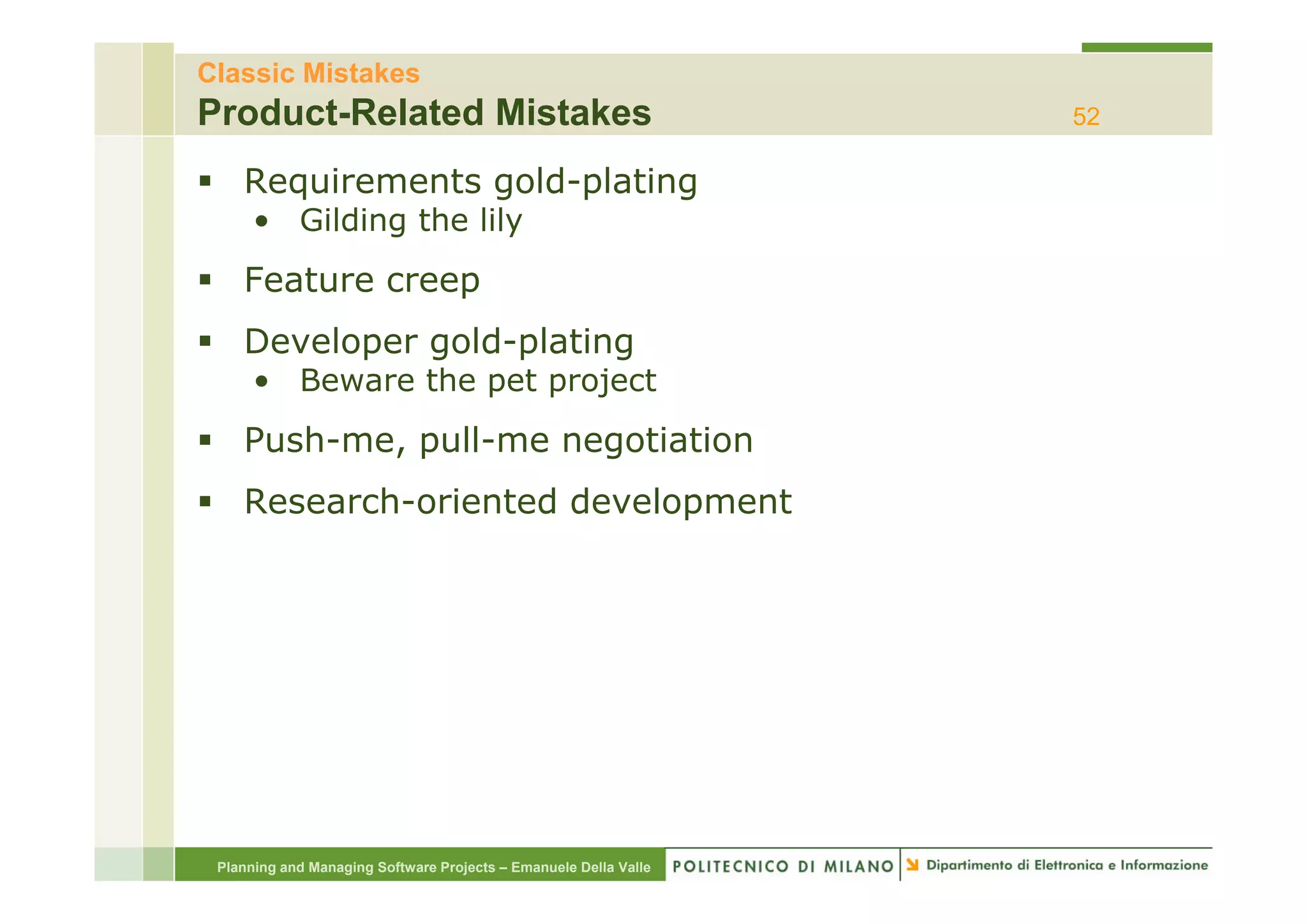

Product-Related Mistakes                                          52

    Requirements gold-plating
      • Gilding the lily
    Feature creep
    Developer g
          p gold-plating
                 p     g
      • Beware the pet project
    Push-me, pull-me negotiation
    Research-oriented development




 Planning and Managing Software Projects – Emanuele Della Valle
Classic Mistakes
Technology-Related Mistakes                                                                                                                      53

    Silver-bullet syndrome
    Overestimated savings from new tools and methods
      • Fad warning




               [ source http://blogs.infosupport.com/blogs/richardz/archive/2010/02/26/dilbert-on-changing-methodology-during-a-project.aspx ]


    Switching tools in mid-project
    Lack of automated source-code control




 Planning and Managing Software Projects – Emanuele Della Valle

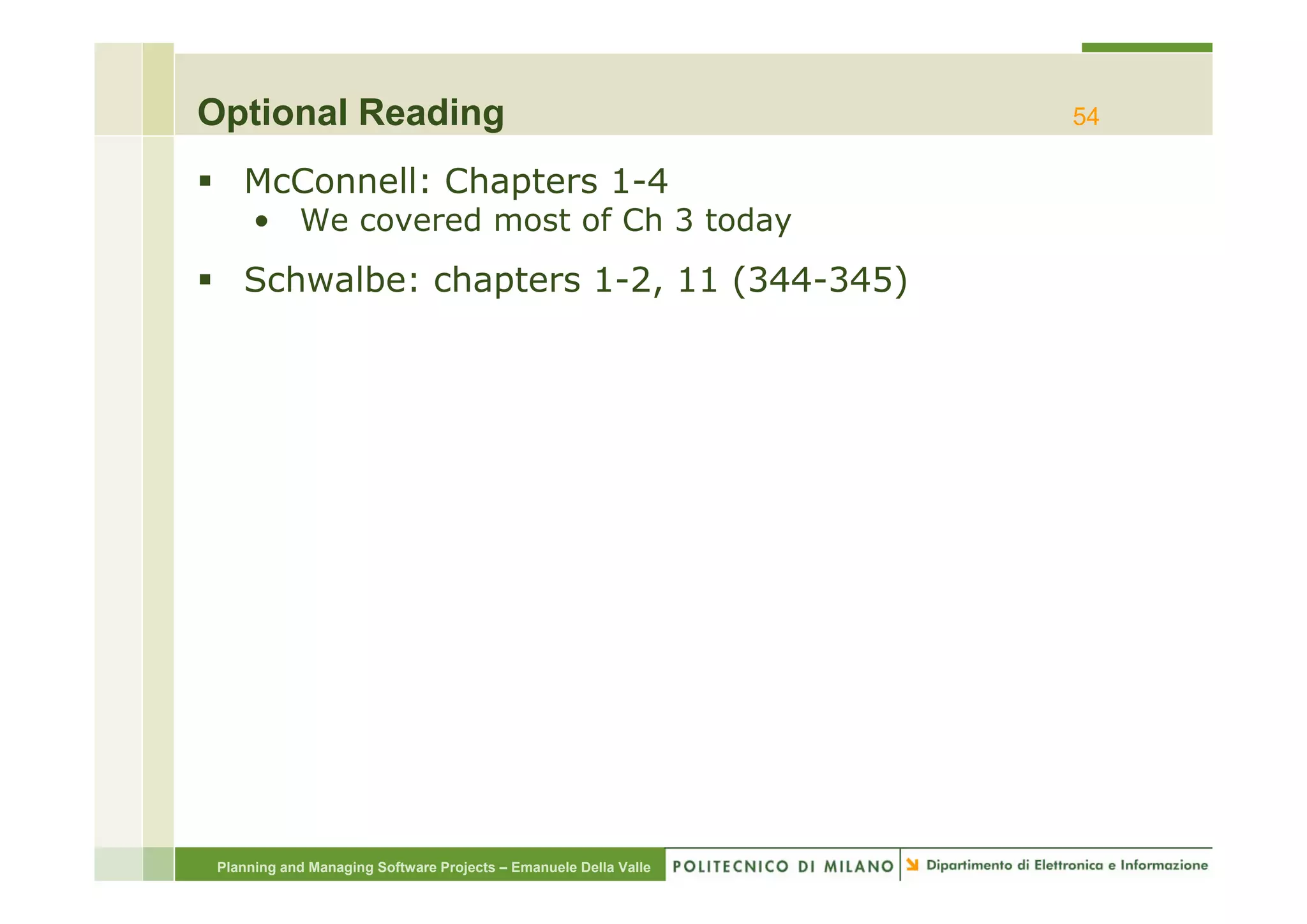

Optional Reading                                                  54

    McConnell: Chapters 1-4
      • We covered most of Ch 3 today
    Schwalbe: chapters 1-2, 11 (344-345)




 Planning and Managing Software Projects – Emanuele Della Valle

Software Project Fundamentals and Classic Mistakes - P&MSP2010 (1/11)

  • 1.
    Session 1 Course Overview EmanueleDella Valle http://home.dei.polimi.it/dellavalle
  • 2.
    Credits 2 This slides are largely based on Prof. John Musser class notes on “Principles of Software Project Management” M t” Original slides are available at http://www.projectreference.com/ htt // j t f / Reuse and republish permission was granted Planning and Managing Software Projects – Emanuele Della Valle
  • 3.
    Today 3 Course basics, administrative items Introductions Fundamentals Classic Mi t k Cl i Mistakes Planning and Managing Software Projects – Emanuele Della Valle
  • 4.
    Course basics, administrativeitems Syllabus Review 4 Class web site • http://emanueledellavalle.org/Teaching/PMSP-2009-10.html Grades Exams Assignments Project Class participation Sessions Planning and Managing Software Projects – Emanuele Della Valle
  • 5.
    Course basics, administrativeitems Textbooks 5 Recommended texts (not mandatory) • These provide two very different viewpoints – I th t In-the-trenches vs. PMI textbook perspective h t tb k ti – “Rapid Development”, Steve McConnell - http://www.stevemcconnell.com/rd.htm – “Information Technology Project Management”, Kathy Schwalbe - http://www.kathyschwalbe.com/ p y More reading • “Quality Software Project Management”, D. Shafer – http://books.google.com/books?id=YYFEqNz7oKcC&printsec=frontcover • “Software Project Survival Guide”, Steve McConnell – http://www.stevemcconnell.com/sg.htm • “Peopleware”, T. DeMarco and T. Lister – http://systemsguild.com/GuildSite/TDM/Tom_DeMarco.html Planning and Managing Software Projects – Emanuele Della Valle
  • 6.
    Course basics, administrativeitems Basics 6 Essential elements of software project management Practical, rapid development focus Real-world case studies • And other examples like j p job interviews Highly interactive Dry as toast? Planning and Managing Software Projects – Emanuele Della Valle
  • 7.
    Course basics, administrativeitems My Background 7 9 years, +50 projects Projects of all shapes and sizes • 80% in research 20% for industries i h f i d t i • 20% lasting 2-3 years 80% lasting 2-6 weeks Areas of expertise p • Web – Semantic Web – Web Services – Web 2.0 • Information System Integration – Service Oriented Architecture – Semantic SOA – Business Process Management • Knowledge Management Systems – Information Portals – Semantic Search Application sectors: healthcare, government, b2b healthcare government Planning and Managing Software Projects – Emanuele Della Valle
  • 8.
    Course basics, administrativeitems Your Background 8 Name Day Job or Equivalent Final Project Project M P j t Management Experience tE i Industry Experience Expectations & goals from the class Planning and Managing Software Projects – Emanuele Della Valle
  • 9.
    Introduction The Field 9 Jobs: where are they? • http://dice.com PM vs. Developers Professional Organizations • Project Management Institute (PMI) (pmi.org) • Software Engineering Institute ( g g (SEI) ) • IEEE Software Engineering Group Certifications • PMI PMP – http://en.wikipedia.org/wiki/Project_Management_Professional The “PMBOK” – PMI Body of Knowledge PMBOK Tools • MS Project – Available in A3.3 where we will go for class 6 – http://office.microsoft.com/project • Other similar tools – http://en.wikipedia.org/wiki/List_of_project_management_software Planning and Managing Software Projects – Emanuele Della Valle
  • 10.
    Introduction The Field Part2 10 Average PM salary $81,000 Contract rates for PM s can match techies PM’s PMI certification adds avg. 14% to salary PMI certs, 1993 1,000; 2002: 40,000 t 1993: 1 000 2002 40 000 Other cert: CompTIA Project+ Links: http://www.projectreference.com/#Certification Planning and Managing Software Projects – Emanuele Della Valle
  • 11.
    Introduction Job Fundamentals 11 Skills required PM Positions and roles The process Planning and Managing Software Projects – Emanuele Della Valle
  • 12.
    Introduction - JobFundamentals Project Management Skills 12 Leadership Communications Problem Solving Negotiating N ti ti Influencing the Organization Mentoring p Process and technical expertise Planning and Managing Software Projects – Emanuele Della Valle
  • 13.
    Introduction - JobFundamentals Project Manager Positions 13 Project Administrator / Coordinator Assistant Project Manager Project Manager / Program Manager Executive P E ti Program M Manager V.P. Program Development Planning and Managing Software Projects – Emanuele Della Valle
  • 14.
    Introduction Software Project Management 14 Management Project Management Software Project Management Planning and Managing Software Projects – Emanuele Della Valle
  • 15.
    Introduction PM History ina Nutshell 15 Birth of modern PM: Manhattan Project (the bomb) • See http://en.wikipedia.org/wiki/Manhattan_Project – employed more th l d than 130,000 people and cost nearly $2 130 000 l d t l billion ($24 billion in 2008 dollars) 1970 s: military, defense, 1970’s: military defense construction industry were using PM software 1990 s: 1990’s: large shift to PM-based models PM based • 1985: Total quality management • 1990-93: Re-engineering, self-directed teams • 1996-99: 1996 99: Risk mgmt project offices mgmt, • 2000: Merge & Acquisition, global projects Planning and Managing Software Projects – Emanuele Della Valle
  • 16.
    Introduction Project Management 16 What’s a project? PMI definition • A project is a temporary endeavor undertaken to create a unique product or service – “Temporary” Temporary - Can be years - Result can be lasting - Team can be temporary – “Unique” - Ex: thousands of buildings, but each is unique Progressively elaborated • With repetitive elements • Scope should be constant even as elaboration happens A project manager • Analogy: conductor, coach, captain Planning and Managing Software Projects – Emanuele Della Valle
  • 17.
    Introduction Project vs. ProgramManagement 17 What’s a ‘program’? Mostly differences of scale Often a number of related projects Longer than projects L th j t Definitions vary Ex: Program Manager for OpenOffice Planning and Managing Software Projects – Emanuele Della Valle
  • 18.
    Introduction Interactions / Stakeholders 18 As a PM, who do you interact with? Project Stakeholders • Project sponsor • Executives • Team • Customers • Contractors • Functional managers Managing all stakeholder Expectations is challenging • conflict Planning and Managing Software Projects – Emanuele Della Valle
  • 19.
    Introduction PM Tools: Software 19 Low-end • Basic features, tasks management, charting • A spreadsheet can do Milestones Simplicity do, Mid-market • Handle larger projects multiple projects, analysis tools projects, projects • MS Project (approx. 50% of market) • OpenProj (valid opensource alternative) High-end • Very large projects, specialized needs, enterprise • AMS Realtime http://www amsrealtime com/ http://www.amsrealtime.com/ • Primavera Project Manager http://www.primavera.com/ Planning and Managing Software Projects – Emanuele Della Valle
  • 20.
    Introduction Tools: Gantt Chart 20 Planning and Managing Software Projects – Emanuele Della Valle
  • 21.
    Introduction Tools: Network Diagram 21 Planning and Managing Software Projects – Emanuele Della Valle
  • 22.
    Fundamentals PMI’s 9 KnowledgeAreas 22 Project integration management Scope Time Cost C t Quality Human resource Communications Risk Procurement Planning and Managing Software Projects – Emanuele Della Valle
  • 23.
    Fundamentals First Principles 23 One size does not fit all! Patterns and Anti-Patterns (see Classic Mistakes later) Anti Patterns Spectrums • Project types j yp • Sizes • Formality and rigor Project are like families, each dysfunctional in it’s own “special way” special way Planning and Managing Software Projects – Emanuele Della Valle
  • 24.
    Fundamentals Our Pattern: RapidDevelopment 24 Faster delivery Reduced risk Increased visibility to customer Don’t f D ’t forsake quality k lit Planning and Managing Software Projects – Emanuele Della Valle
  • 25.
    Fundamentals Rapid Development Strategy 25 Classic Mistake Avoidance Development Fundamentals Risk Management Schedule-Oriented Practices S h d l O i t dP ti Planning and Managing Software Projects – Emanuele Della Valle
  • 26.
    Fundamentals Four Project Dimensions 26 People Process Product Technology T h l Planning and Managing Software Projects – Emanuele Della Valle
  • 27.
    Fundamentals Trade-off Triangle 27 Fast, cheap, good. Choose two. Planning and Managing Software Projects – Emanuele Della Valle
  • 28.
    Fundamentals Comics 28 Source: http://geekandpoke.typepad.com/geekandpoke/2009/11/thats-why-we-love-this-job.html Planning and Managing Software Projects – Emanuele Della Valle
  • 29.
    Fundamentals Trade-off Triangle 29 Know which of these are fixed & variable for every project Planning and Managing Software Projects – Emanuele Della Valle
  • 30.
    Fundamentals – FourDimensions People 30 “It’s always a people problem” - Gerald Weinberg, “The Secrets of Consulting” Developer productivity: 10-to-1 range • Read more: http://forums.construx.com/blogs/stevemcc/archive/200 http://forums construx com/blogs/stevemcc/archive/200 8/03/27/productivity-variations-among-software- developers-and-teams-the-origin-of-quot-10x-quot.aspx Improvements: • Team selection • Team organization • Motivation Planning and Managing Software Projects – Emanuele Della Valle
  • 31.
    Fundamentals – FourDimensions People 2 31 Other success factors • Matching people to tasks • Career development • Balance: individual and team • Clear communication Planning and Managing Software Projects – Emanuele Della Valle
  • 32.
    Fundamentals – FourDimensions Process 32 Is process stifling? 2 Types: Management & Technical Development fundamentals Quality Q lit assurance Risk management Lifecycle planning Avoid abuse by neglect y g Planning and Managing Software Projects – Emanuele Della Valle
  • 33.
    Fundamentals – FourDimensions Process 2 33 Customer orientation Process maturity improvement Rework avoidance Planning and Managing Software Projects – Emanuele Della Valle
  • 34.
    Fundamentals – FourDimensions Product 34 The “tangible” dimension Product size management Product characteristics and requirements Feature creep management F t t Planning and Managing Software Projects – Emanuele Della Valle
  • 35.
    Fundamentals – FourDimensions Technology 35 Often the least important dimension Language and tool selection Value and cost of reuse Planning and Managing Software Projects – Emanuele Della Valle
  • 36.
    Fundamentals Planning 36 Determine requirements Determine resources Select lifecycle model Determine product features strategy D t i d tf t t t Planning and Managing Software Projects – Emanuele Della Valle
  • 37.
    Fundamentals Tracking 37 Cost, effort, schedule Planned vs. Actual How to handle when things go off plan? Planning and Managing Software Projects – Emanuele Della Valle
  • 38.
    Fundamentals Measurements 38 To date and projected • Cost • Schedule • Effort • Product features Alternatives • Earned value analysis • Defect rates • Productivity (ex: SLOC) • Complexity (ex: function points) Planning and Managing Software Projects – Emanuele Della Valle
  • 39.
    Fundamentals Technical Fundamentals 39 Requirements Analysis Design Construction C t ti Quality Assurance Deployment Planning and Managing Software Projects – Emanuele Della Valle
  • 40.
    Fundamentals Project Phases 40 All projects are divided into phases All phases together are known as the Project Life Cycle Each phase is marked by completion of Deliverables Identify th Id tif the primary software project phases i ft j t h Planning and Managing Software Projects – Emanuele Della Valle
  • 41.
    Fundamentals Lifecycle Relationships 41 Planning and Managing Software Projects – Emanuele Della Valle
  • 42.
    Fundamentals Seven Core ProjectPhases 42 Planning and Managing Software Projects – Emanuele Della Valle
  • 43.
    Fundamentals Project Phases A.K.A. 43 Planning and Managing Software Projects – Emanuele Della Valle
  • 44.
    Fundamentals Phases Variation 44 Concept Exploration System S t Exploration Requirements Design Implementation Installation Operations and Support Maintenance Retirement Planning and Managing Software Projects – Emanuele Della Valle
  • 45.
    36 Classic Mistakes 45 McConnell’s Anti-Patterns • The mistakes http://www.stevemcconnell.com/rdenum.htm • A case study htt // http://www.stevemcconnell.com/rdmistak.htm t ll / d i t k ht Seductive Appeal Types • People-Related • Process Related Process-Related • Product-Related • Technology-Related Gilligan’s Island • Every week there's some new, crazy scheme to escape the island, but at the end of the episode, the castaways , p , y always end up stuck on the island for yet another week. • See http://www.codinghorror.com/blog/archives/000889.html Planning and Managing Software Projects – Emanuele Della Valle
  • 46.
    Classic Mistakes People-Related MistakesPart 1 46 Undermined motivation Weak personnel • Weak vs. Junior Uncontrolled problem employees p p y Heroics Adding people to a late project Planning and Managing Software Projects – Emanuele Della Valle
  • 47.
    Classic Mistakes People-Related MistakesPart 2 47 Noisy, crowded offices Customer Developer Customer-Developer friction Unrealistic expectations Politics P liti over substance b t Wishful thinking Planning and Managing Software Projects – Emanuele Della Valle
  • 48.
    Classic Mistakes People-Related MistakesPart 3 48 Lack of effective project sponsorship Lack of stakeholder buy-in buy in Lack of user input Planning and Managing Software Projects – Emanuele Della Valle
  • 49.
    Classic Mistakes Process-Related MistakesPart 1 49 Optimistic schedules Insufficient risk management Contractor failure Insufficient planning I ffi i t l i Abandonment of plan under pressure Planning and Managing Software Projects – Emanuele Della Valle
  • 50.
    Classic Mistakes Process-Related MistakesPart 2 50 Wasted time during fuzzy front end Shortchanged upstream activities Inadequate design Shortchanged quality assurance Sh t h d lit Planning and Managing Software Projects – Emanuele Della Valle
  • 51.
    Classic Mistakes Process-Related MistakesPart 3 51 Insufficient management controls Frequent convergence Omitting necessary tasks from estimates Planning t catch-up l t Pl i to t h later Code-like-hell programming Planning and Managing Software Projects – Emanuele Della Valle
  • 52.
    Classic Mistakes Product-Related Mistakes 52 Requirements gold-plating • Gilding the lily Feature creep Developer g p gold-plating p g • Beware the pet project Push-me, pull-me negotiation Research-oriented development Planning and Managing Software Projects – Emanuele Della Valle
  • 53.
    Classic Mistakes Technology-Related Mistakes 53 Silver-bullet syndrome Overestimated savings from new tools and methods • Fad warning [ source http://blogs.infosupport.com/blogs/richardz/archive/2010/02/26/dilbert-on-changing-methodology-during-a-project.aspx ] Switching tools in mid-project Lack of automated source-code control Planning and Managing Software Projects – Emanuele Della Valle
  • 54.
    Optional Reading 54 McConnell: Chapters 1-4 • We covered most of Ch 3 today Schwalbe: chapters 1-2, 11 (344-345) Planning and Managing Software Projects – Emanuele Della Valle
