Job Scheduling
Sanjay Singh
Devis Karumanchi
Durgesh Waghmare
Litun Patra
Problem statement

Consider the following variation on the Interval Scheduling Problem. You
have a processor that can operate 24 hours a day, every day. People
submit requests to run daily jobs on the processor. Each such job comes
with a start time and an end time; if the job is accepted to run on the
processor, it must run continuously, every day, for the period between its
start and end times. Given a list of n such jobs, your goal is to accept as
many jobs as possible (regardless of their length), subject to the constraint
that the processor can run at most one job at any given point in time.
Provide an algorithm to do this with a running time that is polynomial in n.
You may assume for simplicity that no two jobs have the same start or end
times. Example. Consider the following four jobs, specified by (start time,
end-time) pairs. (6 P.M., 6 A.M.), (9 P.M., 4 A.M.), (3 A.M., 2 P.M.), (1 P.M., 7
P.M.). The optimal solution would be to pick the two jobs (9 P.M., 4 A.M.)
and (1P.M., 7 P.M.), which can be scheduled without overlapping.

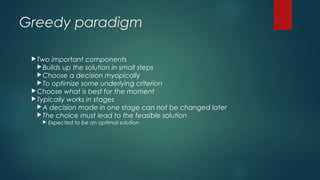

Greedy paradigm
Two important components
Builds up the solution in small steps
Choose a decision myopically
To optimize some underlying criterion
Choose what is best for the moment
Typically works in stages
A decision made in one stage can not be changed later
The choice must lead to the feasible solution
 Expected to be an optimal solution
Activity selection problem
Selecting maximal set of mutually compatible activities
Simple and elegant method
Mutually compatible activities
If each activity i occurs during the half open interval [si, fi)
When do [si, fi) and [sj, fj) not overlap?
i < j or j < i

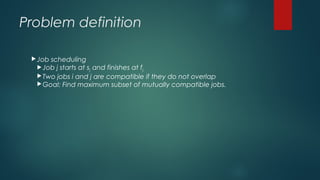

Problem definition
Job scheduling
Job j starts at sj and finishes at fj
Two jobs i and j are compatible if they do not overlap
Goal: Find maximum subset of mutually compatible jobs.

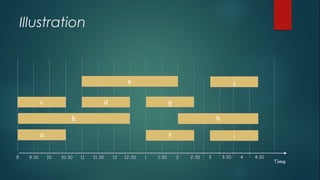

Illustration

Interval Scheduling
Greedy template. Consider jobs in some order. Take each job provided it's compatible
with the ones already taken.
- [Earliest start time] Consider jobs in ascending order of start time sj.
- [Earliest finish time] Consider jobs in ascending order of finish time fj.
- [Shortest interval] Consider jobs in ascending order of interval length fj – sj.
- [Fewest conflicts] For each job, count the number of conflicting jobs cj. Schedule
in ascending order of conflicts cj. `

The strategies that fail
“Earliest start time” fails
“Shortest interval” fails
“Fewer conflict strategy” fails

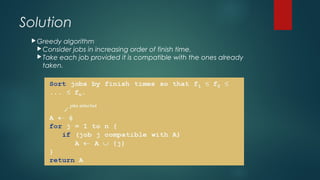

Solution
Greedy algorithm
Consider jobs in increasing order of finish time.
Take each job provided it is compatible with the ones already
taken.

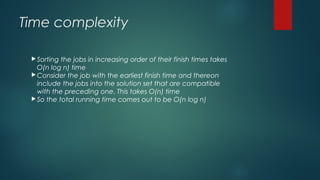

Time complexity
Sorting the jobs in increasing order of their finish times takes
O(n log n) time
Consider the job with the earliest finish time and thereon
include the jobs into the solution set that are compatible
with the preceding one. This takes O(n) time
So the total running time comes out to be O(n log n)
Thank you
