New Product Introduction Process
August 16, 2016

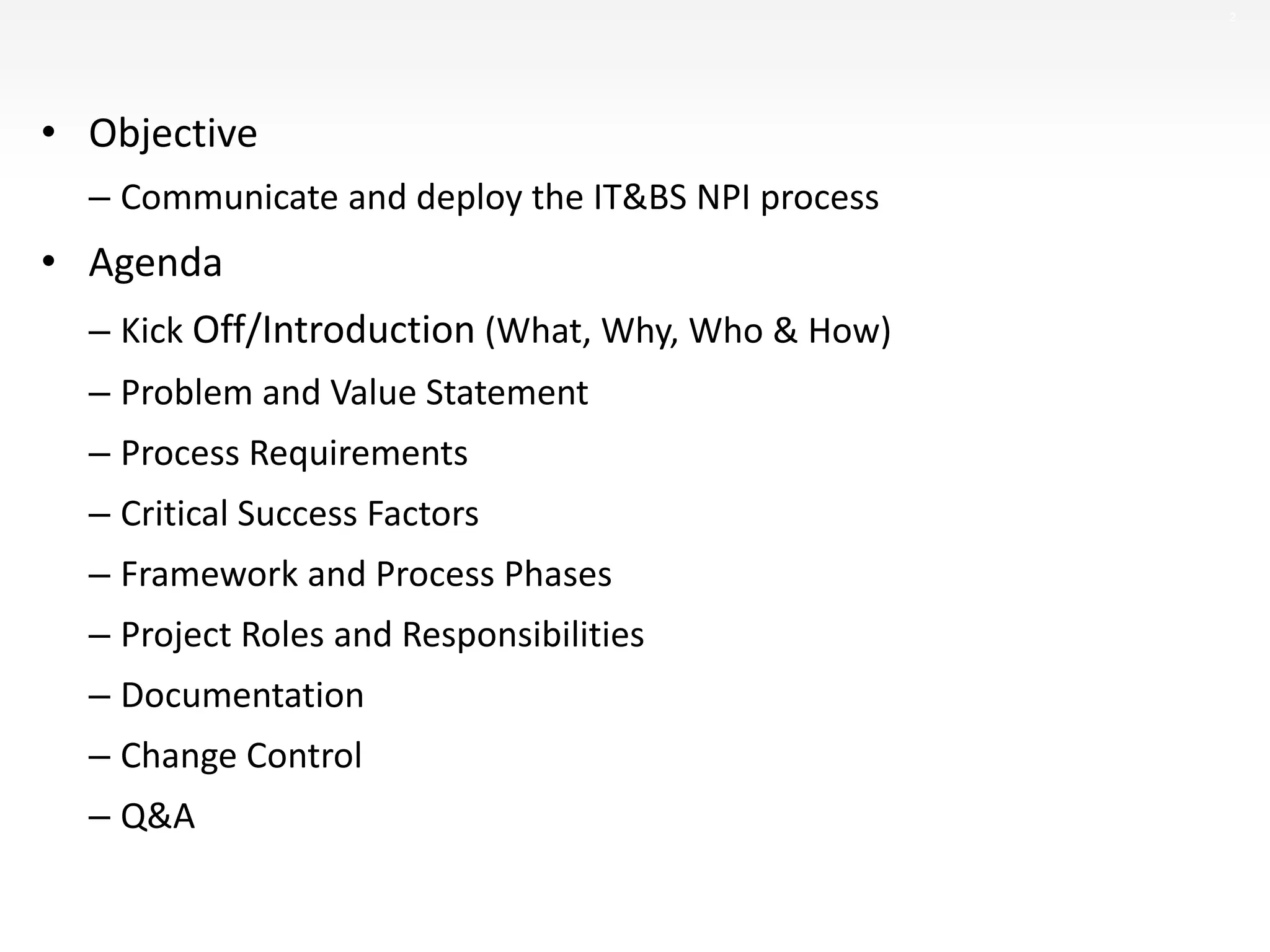

2
• Objective
– Communicate and deploy the IT&BS NPI process
• Agenda
– Kick Off/Introduction (What, Why, Who & How)
– Problem and Value Statement
– Process Requirements
– Critical Success Factors
– Framework and Process Phases
– Project Roles and Responsibilities
– Documentation
– Change Control
– Q&A

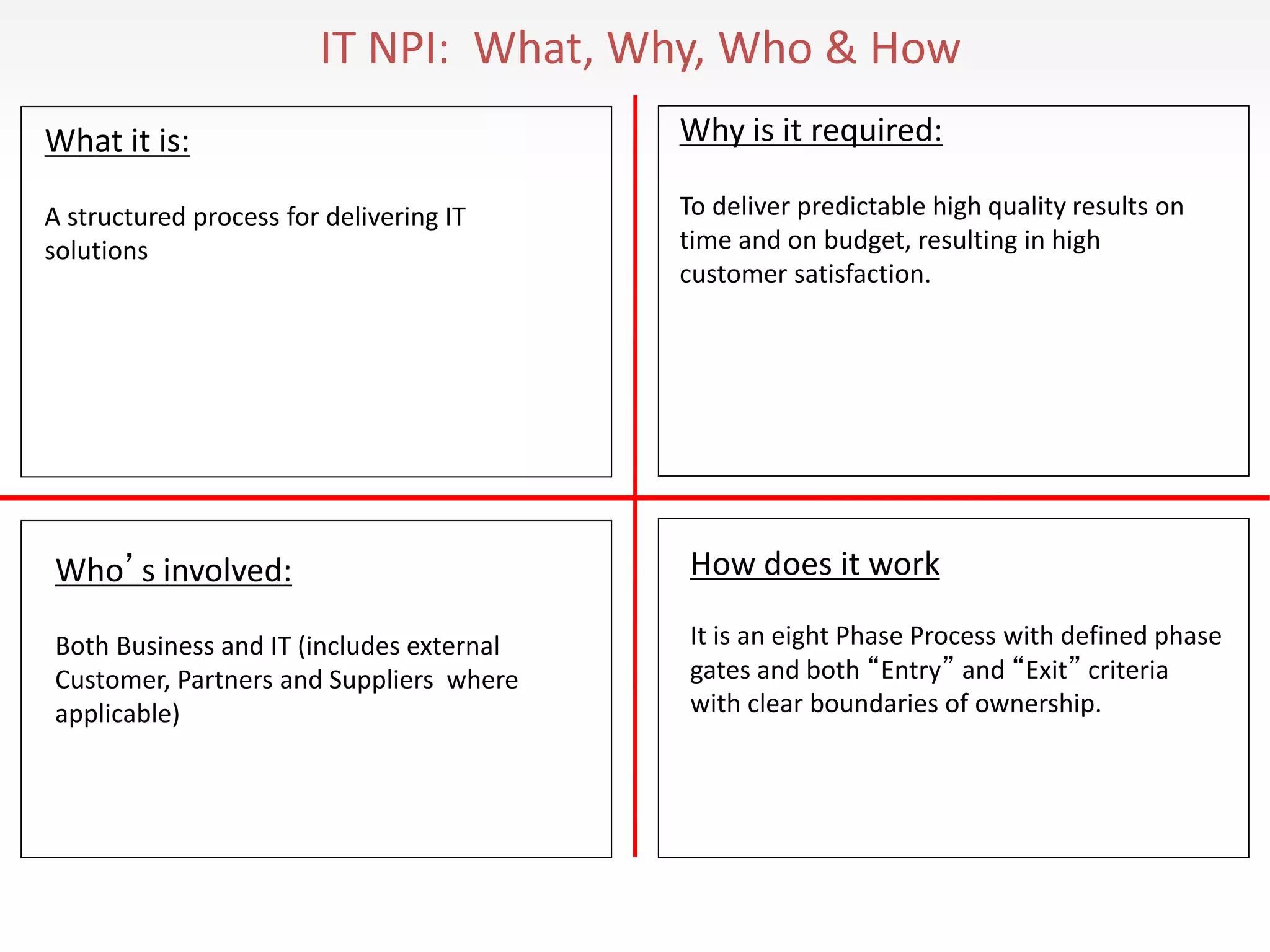

IT NPI: What, Why, Who & How
What it is:
A structured process for delivering IT
solutions
Why is it required:
To deliver predictable high quality results on
time and on budget, resulting in high
customer satisfaction.
Who’s involved:
Both Business and IT (includes external
Customer, Partners and Suppliers where
applicable)
How does it work
It is an eight Phase Process with defined phase
gates and both “Entry” and “Exit” criteria
with clear boundaries of ownership.
4

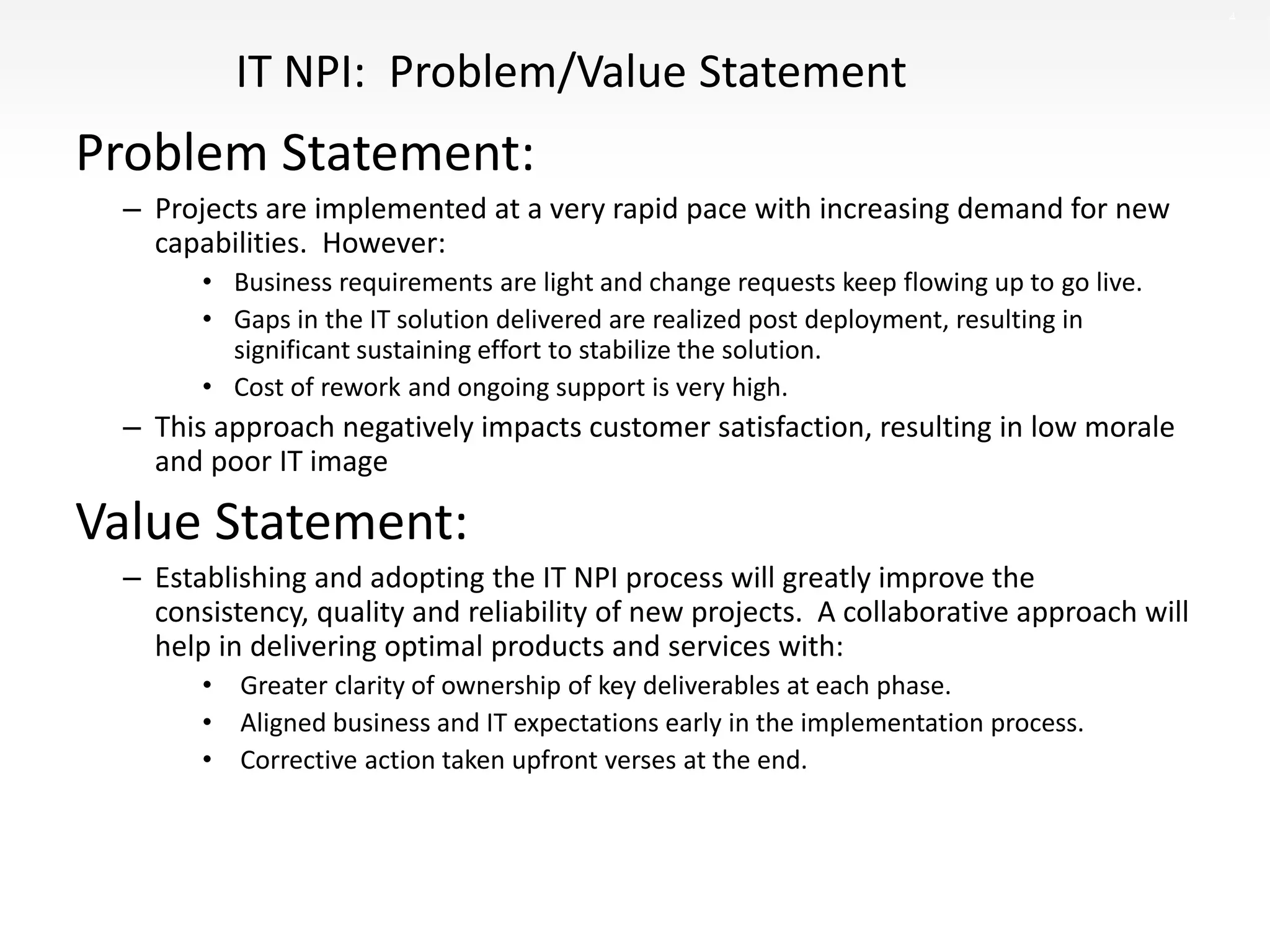

IT NPI: Problem/Value Statement
Problem Statement:
– Projects are implemented at a very rapid pace with increasing demand for new
capabilities. However:
• Business requirements are light and change requests keep flowing up to go live.
• Gaps in the IT solution delivered are realized post deployment, resulting in
significant sustaining effort to stabilize the solution.
• Cost of rework and ongoing support is very high.
– This approach negatively impacts customer satisfaction, resulting in low morale
and poor IT image
Value Statement:
– Establishing and adopting the IT NPI process will greatly improve the
consistency, quality and reliability of new projects. A collaborative approach will
help in delivering optimal products and services with:
• Greater clarity of ownership of key deliverables at each phase.
• Aligned business and IT expectations early in the implementation process.
• Corrective action taken upfront verses at the end.
5

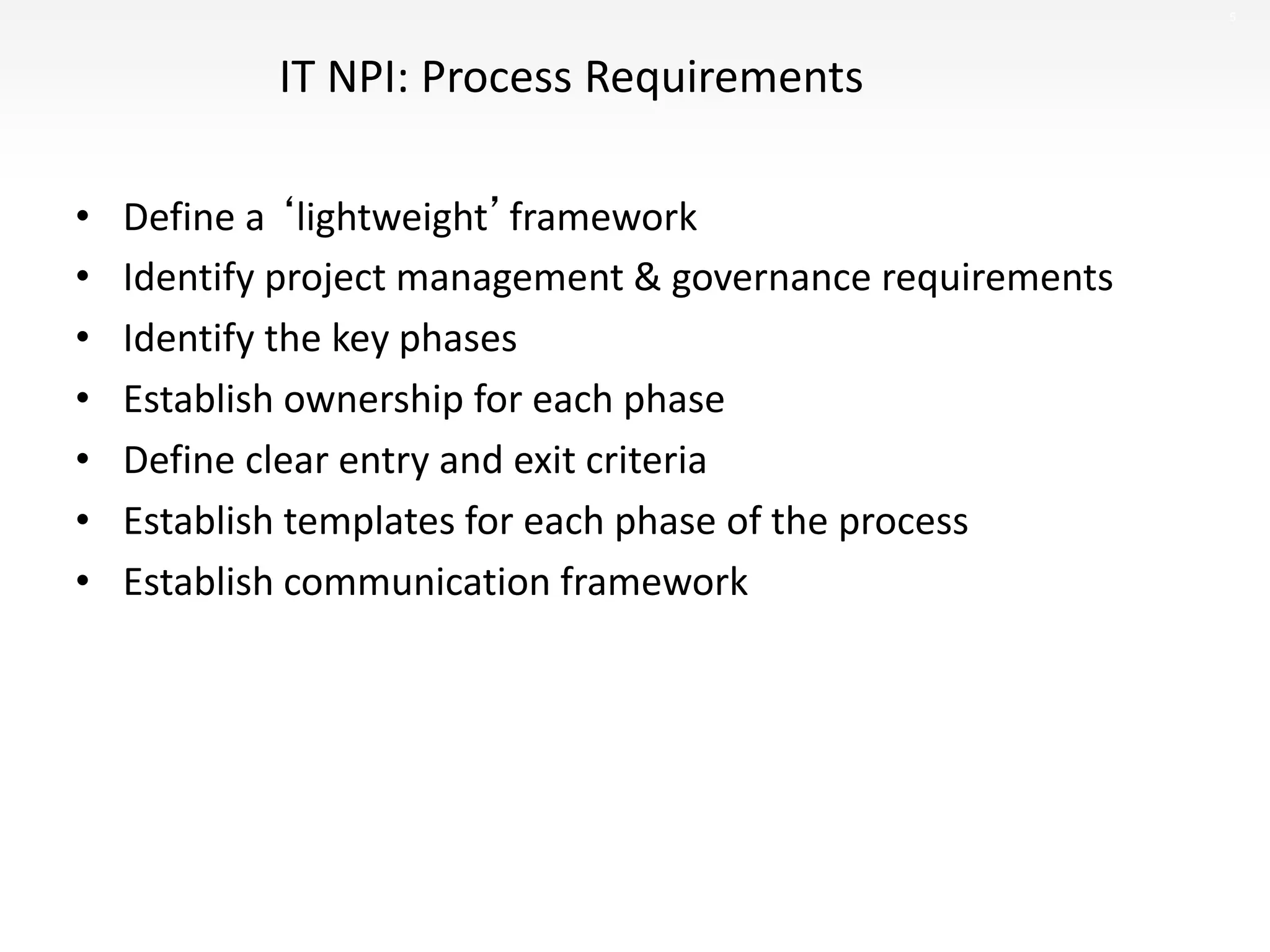

IT NPI: Process Requirements
• Define a ‘lightweight’framework
• Identify project management & governance requirements
• Identify the key phases
• Establish ownership for each phase
• Define clear entry and exit criteria
• Establish templates for each phase of the process
• Establish communication framework
6

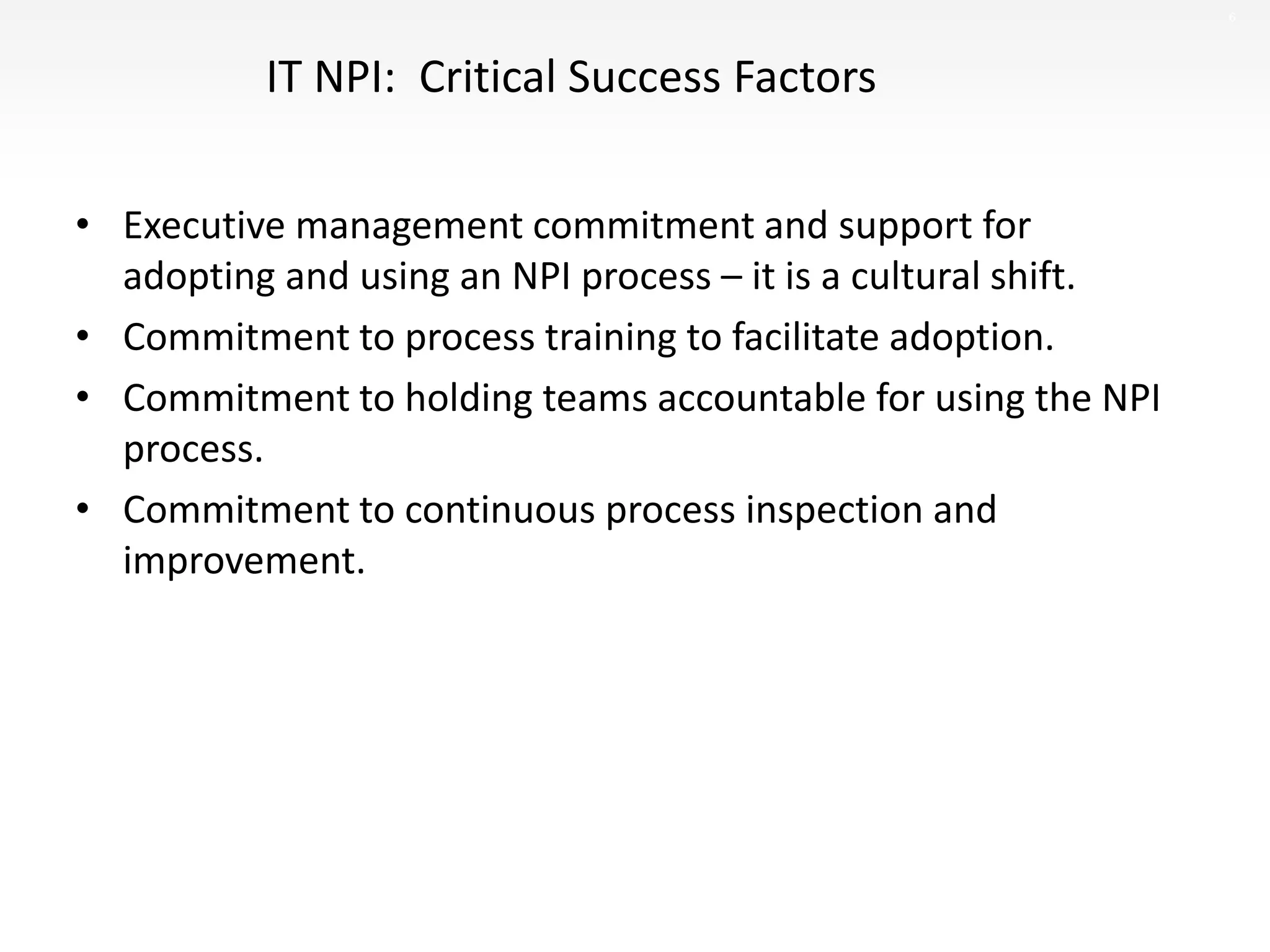

IT NPI: Critical Success Factors
• Executive management commitment and support for
adopting and using an NPI process – it is a cultural shift.
• Commitment to process training to facilitate adoption.
• Commitment to holding teams accountable for using the NPI
process.
• Commitment to continuous process inspection and
improvement.
IT NPI Process Metrics

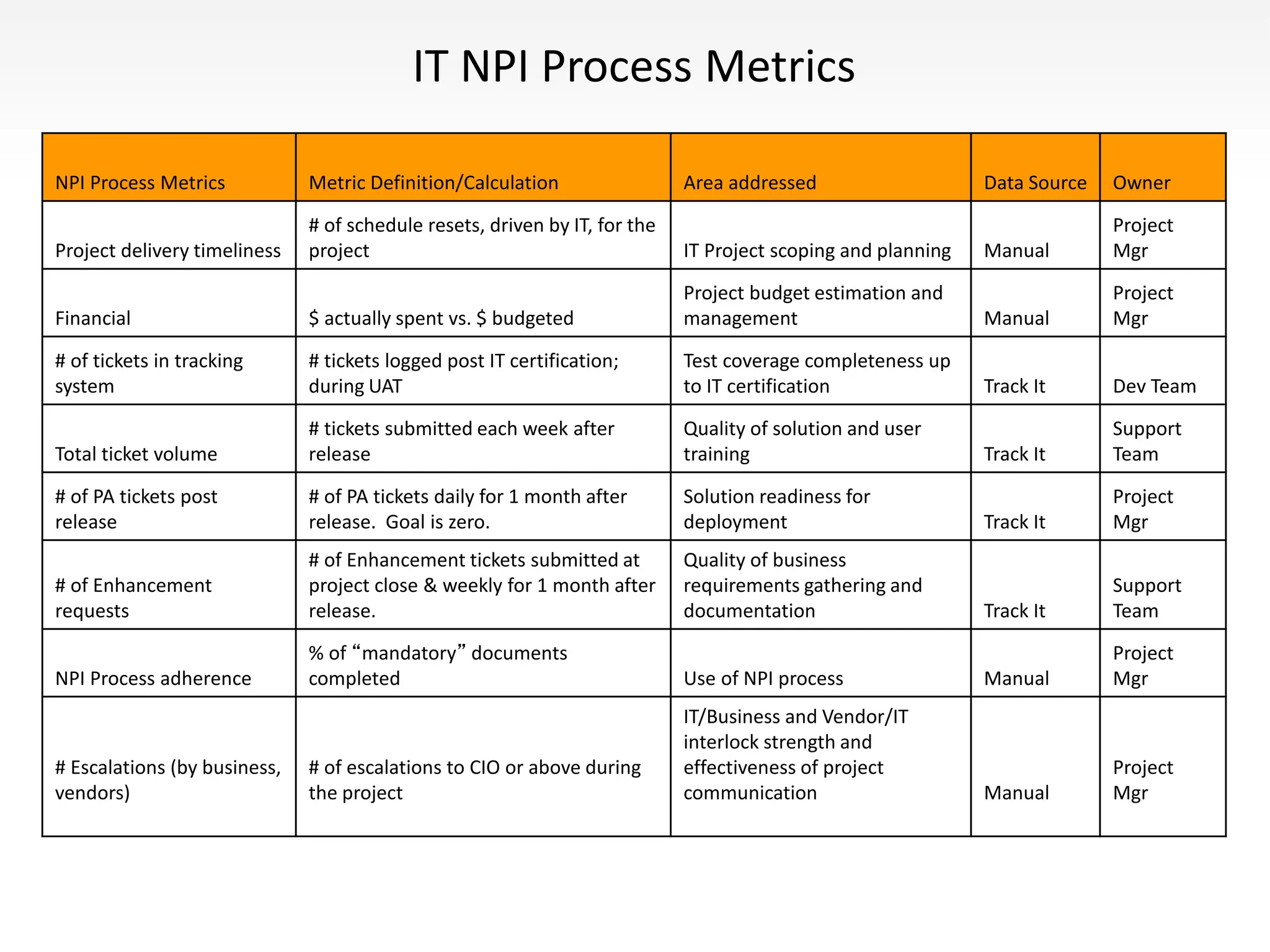

NPI Process Metrics Metric Definition/Calculation Area addressed Data Source Owner
Project delivery timeliness
# of schedule resets, driven by IT, for the
project IT Project scoping and planning Manual
Project
Mgr
Financial $ actually spent vs. $ budgeted
Project budget estimation and
management Manual
Project
Mgr
# of tickets in tracking
system
# tickets logged post IT certification;
during UAT
Test coverage completeness up
to IT certification Track It Dev Team
Total ticket volume
# tickets submitted each week after
release
Quality of solution and user
training Track It
Support
Team
# of PA tickets post
release
# of PA tickets daily for 1 month after
release. Goal is zero.
Solution readiness for
deployment Track It
Project
Mgr
# of Enhancement
requests
# of Enhancement tickets submitted at
project close & weekly for 1 month after
release.
Quality of business
requirements gathering and
documentation Track It
Support
Team
NPI Process adherence
% of “mandatory” documents
completed Use of NPI process Manual
Project
Mgr
# Escalations (by business,
vendors)
# of escalations to CIO or above during
the project
IT/Business and Vendor/IT
interlock strength and
effectiveness of project
communication Manual
Project
Mgr

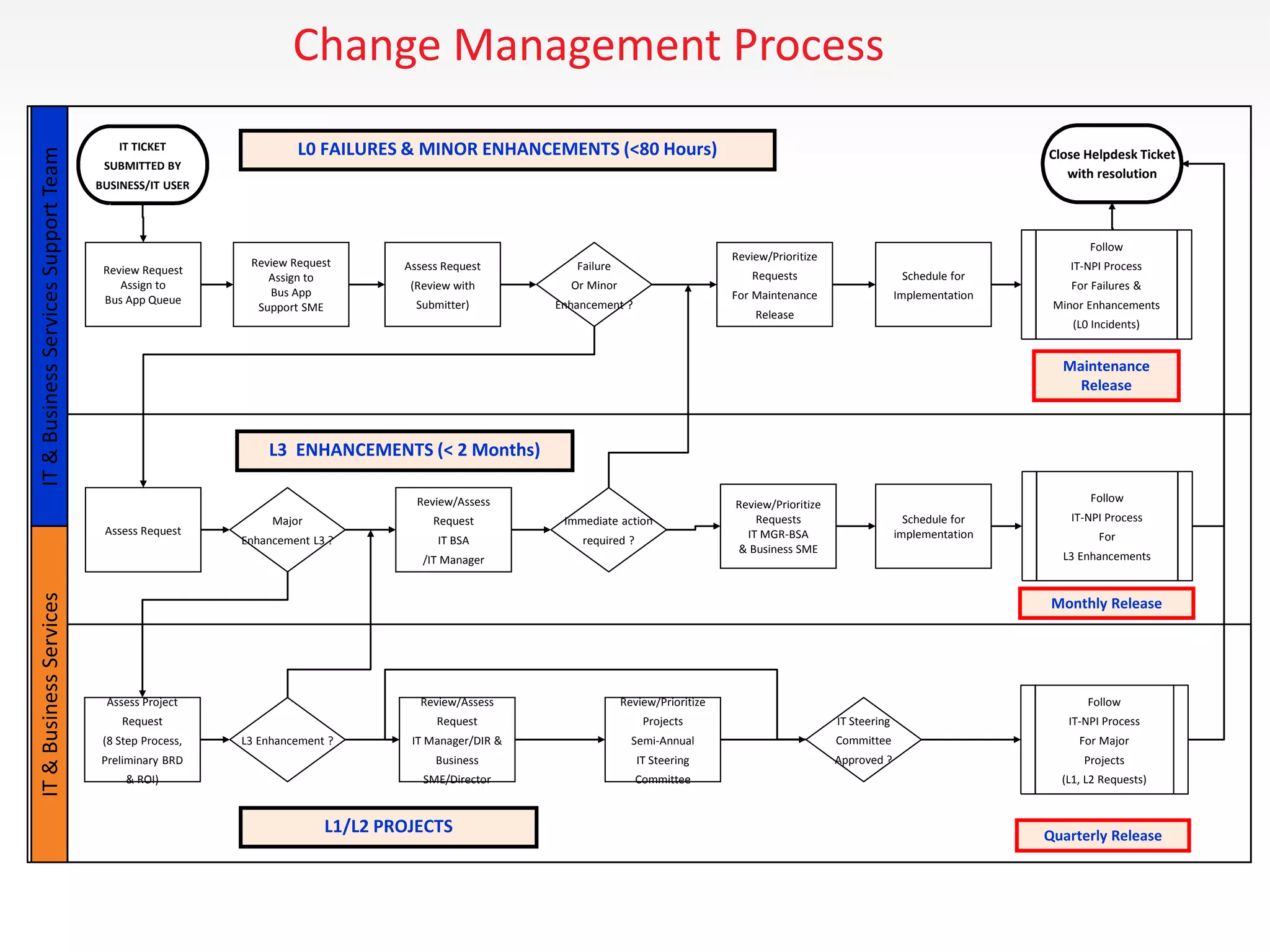

Review Request
Assign to
Bus App Queue
Assess Request
(Review with
Submitter)
Review/Prioritize
Requests
For Maintenance
Release
IT TICKET
SUBMITTED BY
BUSINESS/IT USER
Close Helpdesk Ticket
with resolution
Major
Enhancement L3 ?
Review/Assess
Request
IT BSA
/IT Manager
Immediate action
required ?
Review/Prioritize
Requests
IT MGR-BSA
& Business SME
Follow
IT-NPI Process
For
L3 Enhancements
Assess Project
Request
(8 Step Process,
Preliminary BRD
& ROI)
Review/Prioritize
Projects
Semi-Annual
IT Steering
Committee
IT Steering
Committee
Approved ?
Follow
IT-NPI Process
For Major
Projects
(L1, L2 Requests)
Maintenance
Release
Quarterly Release
Failure
Or Minor
Enhancement ?
Assess Request
Schedule for
Implementation
Schedule for
implementation
Monthly Release
IT&BusinessServicesSupportTeamIT&BusinessServices
L3 Enhancement ?
Review/Assess
Request
IT Manager/DIR &
Business
SME/Director
Review Request
Assign to
Bus App
Support SME
Follow
IT-NPI Process
For Failures &
Minor Enhancements
(L0 Incidents)
L3 ENHANCEMENTS (< 2 Months)
L0 FAILURES & MINOR ENHANCEMENTS (<80 Hours)
L1/L2 PROJECTS
Change Management Process

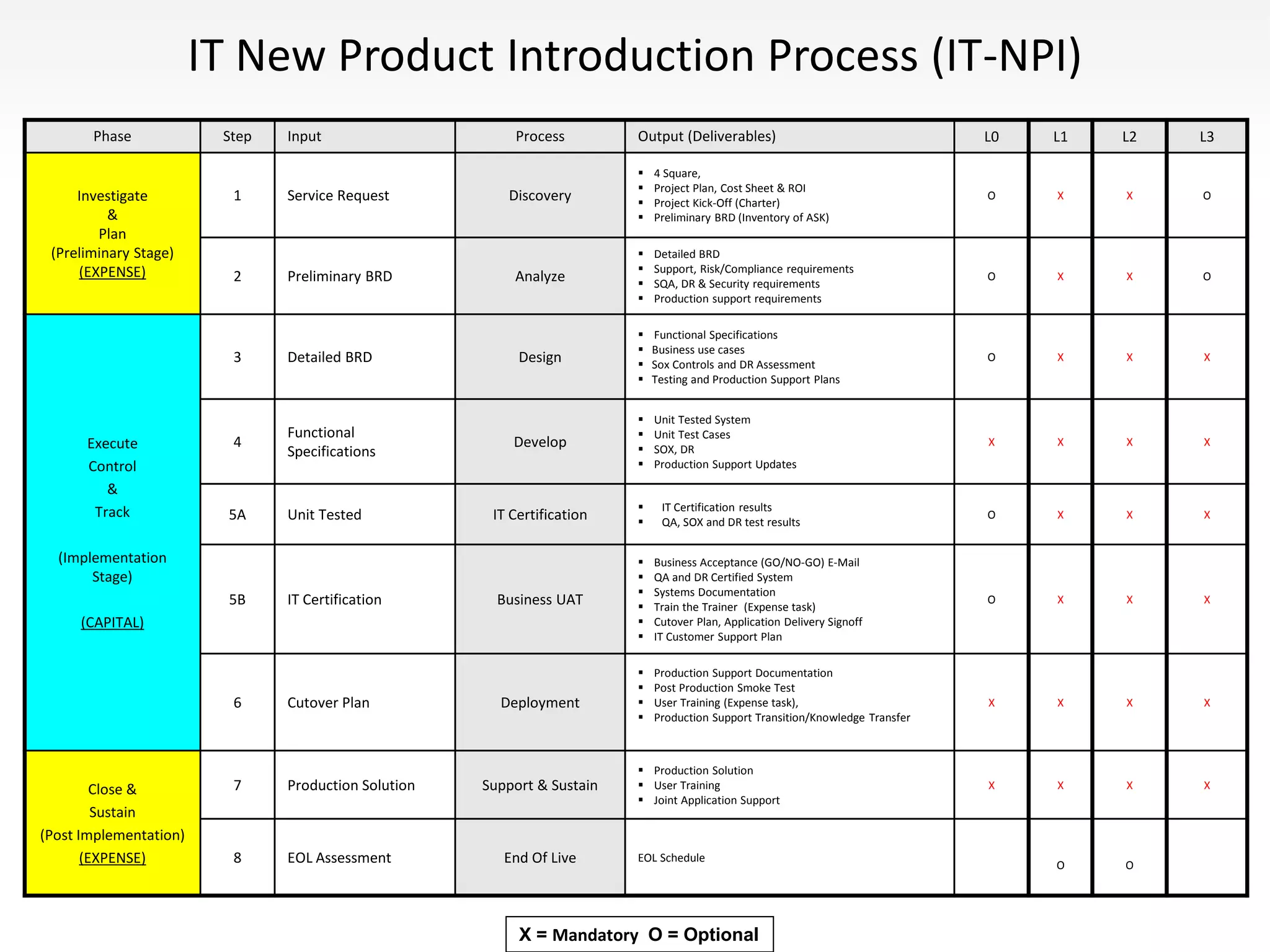

IT New Product Introduction Process (IT-NPI)
Phase Step Input Process Output (Deliverables) L0 L1 L2 L3
Investigate
&
Plan
(Preliminary Stage)
(EXPENSE)
1 Service Request Discovery
 4 Square,
 Project Plan, Cost Sheet & ROI
 Project Kick-Off (Charter)
 Preliminary BRD (Inventory of ASK)
O X X O
2 Preliminary BRD Analyze
 Detailed BRD
 Support, Risk/Compliance requirements
 SQA, DR & Security requirements
 Production support requirements
O X X O
Execute
Control
&
Track
(Implementation
Stage)
(CAPITAL)
3 Detailed BRD Design
 Functional Specifications
 Business use cases
 Sox Controls and DR Assessment
 Testing and Production Support Plans
O X X X
4
Functional
Specifications
Develop
 Unit Tested System
 Unit Test Cases
 SOX, DR
 Production Support Updates
X X X X
5A Unit Tested IT Certification
 IT Certification results
 QA, SOX and DR test results
O X X X
5B IT Certification Business UAT
 Business Acceptance (GO/NO-GO) E-Mail
 QA and DR Certified System
 Systems Documentation
 Train the Trainer (Expense task)
 Cutover Plan, Application Delivery Signoff
 IT Customer Support Plan
O X X X
6 Cutover Plan Deployment
 Production Support Documentation
 Post Production Smoke Test
 User Training (Expense task),
 Production Support Transition/Knowledge Transfer
X X X X
Close &
Sustain
(Post Implementation)
(EXPENSE)
7 Production Solution Support & Sustain
 Production Solution
 User Training
 Joint Application Support
X X X X
8 EOL Assessment End Of Live EOL Schedule
O O
X = Mandatory O = Optional

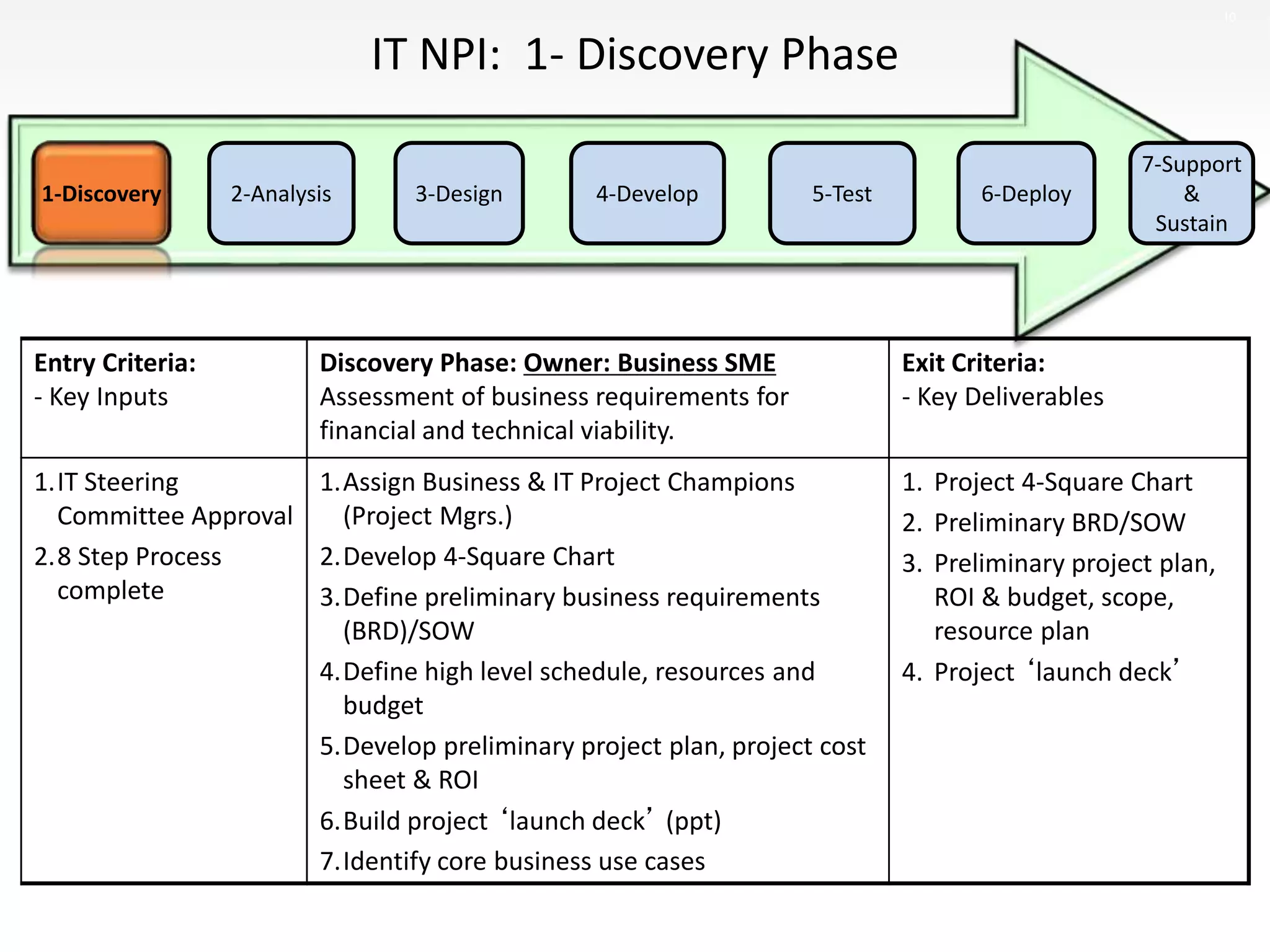

IT NPI: 1- Discovery Phase
10
5-Test3-Design1-Discovery 4-Develop2-Analysis 6-Deploy
7-Support
&
Sustain
Entry Criteria:
- Key Inputs
Discovery Phase: Owner: Business SME
Assessment of business requirements for
financial and technical viability.
Exit Criteria:
- Key Deliverables
1.IT Steering
Committee Approval
2.8 Step Process
complete
1.Assign Business & IT Project Champions
(Project Mgrs.)
2.Develop 4-Square Chart
3.Define preliminary business requirements
(BRD)/SOW
4.Define high level schedule, resources and
budget
5.Develop preliminary project plan, project cost
sheet & ROI
6.Build project ‘launch deck’ (ppt)
7.Identify core business use cases
1. Project 4-Square Chart
2. Preliminary BRD/SOW
3. Preliminary project plan,
ROI & budget, scope,
resource plan
4. Project ‘launch deck’

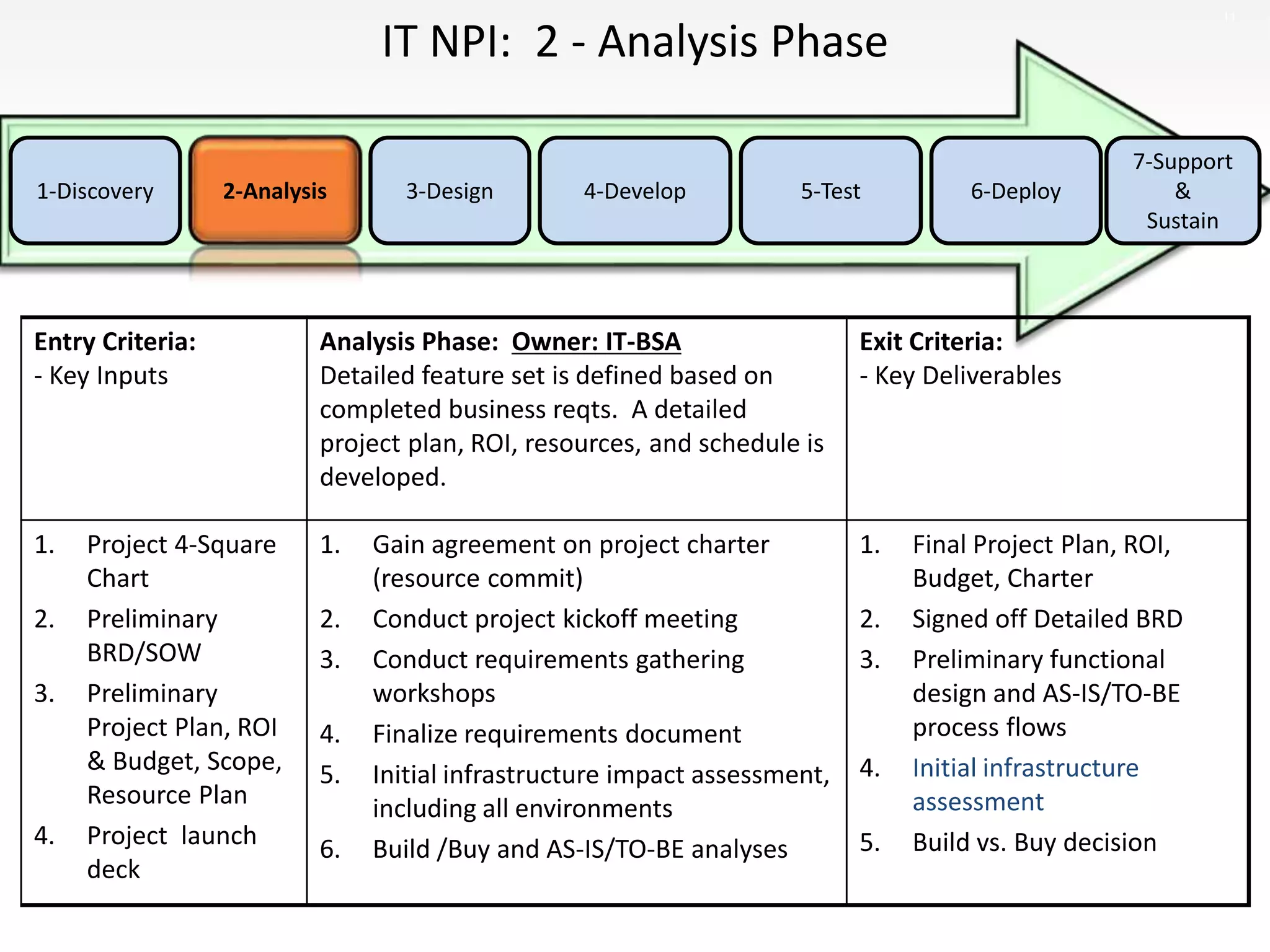

IT NPI: 2 - Analysis Phase
11
5-Test3-Design 4-Develop1-Discovery 6-Deploy
7-Support
&
Sustain
Entry Criteria:
- Key Inputs
Analysis Phase: Owner: IT-BSA
Detailed feature set is defined based on
completed business reqts. A detailed
project plan, ROI, resources, and schedule is
developed.
Exit Criteria:
- Key Deliverables
1. Project 4-Square
Chart
2. Preliminary
BRD/SOW
3. Preliminary
Project Plan, ROI
& Budget, Scope,
Resource Plan
4. Project launch
deck
1. Gain agreement on project charter
(resource commit)
2. Conduct project kickoff meeting
3. Conduct requirements gathering
workshops
4. Finalize requirements document
5. Initial infrastructure impact assessment,
including all environments
6. Build /Buy and AS-IS/TO-BE analyses
1. Final Project Plan, ROI,
Budget, Charter
2. Signed off Detailed BRD
3. Preliminary functional
design and AS-IS/TO-BE
process flows
4. Initial infrastructure
assessment
5. Build vs. Buy decision
2-Analysis

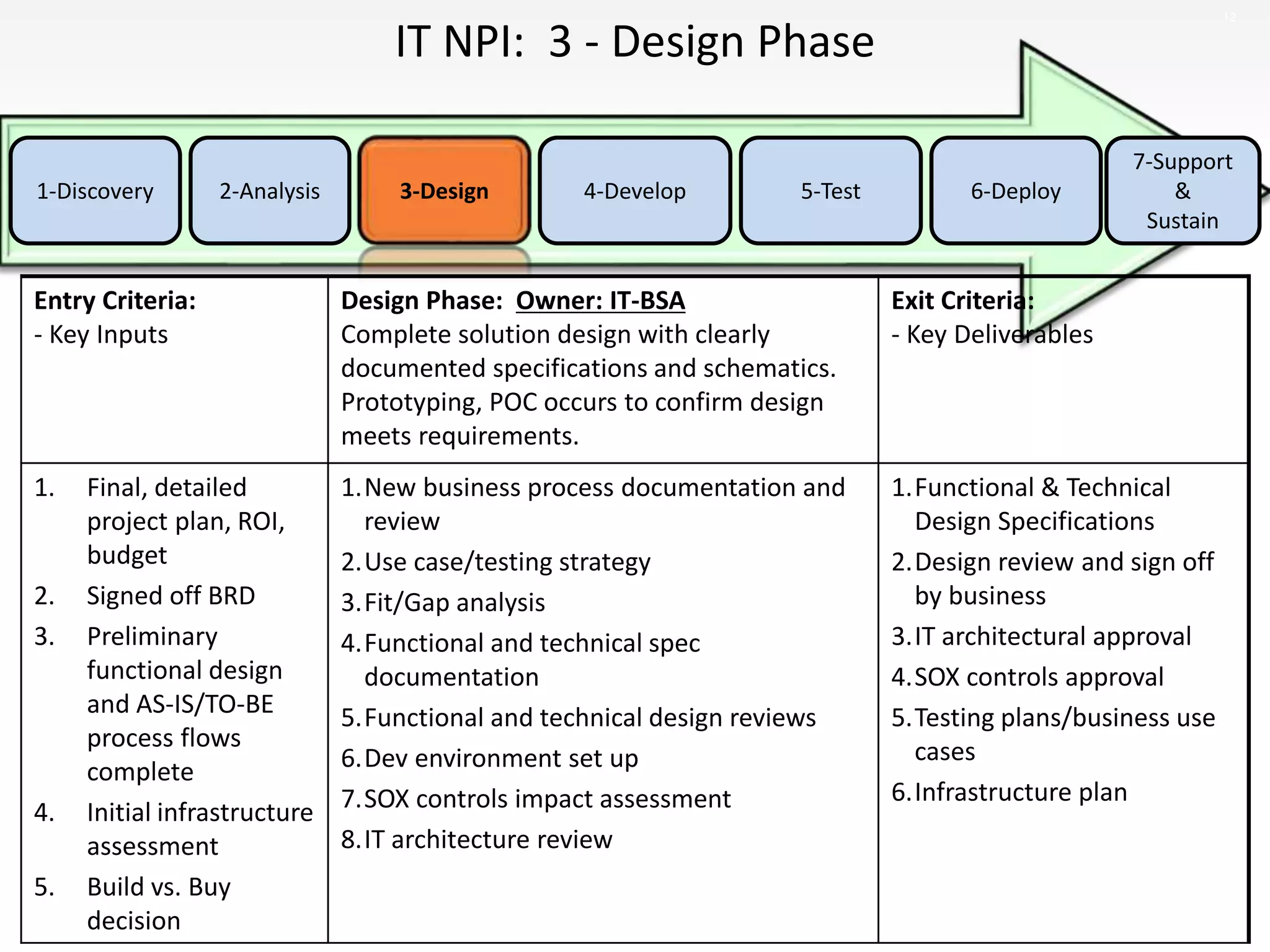

IT NPI: 3 - Design Phase
12
5-Test2-Analysis 4-Develop1-Discovery 6-Deploy
7-Support
&
Sustain
3-Design
Entry Criteria:
- Key Inputs
Design Phase: Owner: IT-BSA
Complete solution design with clearly
documented specifications and schematics.
Prototyping, POC occurs to confirm design
meets requirements.
Exit Criteria:
- Key Deliverables
1. Final, detailed
project plan, ROI,
budget
2. Signed off BRD
3. Preliminary
functional design
and AS-IS/TO-BE
process flows
complete
4. Initial infrastructure
assessment
5. Build vs. Buy
decision
1.New business process documentation and
review
2.Use case/testing strategy
3.Fit/Gap analysis
4.Functional and technical spec
documentation
5.Functional and technical design reviews
6.Dev environment set up
7.SOX controls impact assessment
8.IT architecture review
1.Functional & Technical
Design Specifications
2.Design review and sign off
by business
3.IT architectural approval
4.SOX controls approval
5.Testing plans/business use
cases
6.Infrastructure plan
Entry Criteria:
- Key Inputs
Development Phase – Owner: IT Technical
Analyst Solution coding, design reviews, and
unit testing occurs. System, integration,
regression, UAT test plans developed.
Exit Criteria:
- Key Deliverables
1. Functional &
technical design
specifications
2. Design review and
sign off by business
3. IT architectural
review, approval
4. SOX controls review,
approval
5. Testing
strategy/business
use cases
6. Infrastructure plan
1.Code reviews
2.Code merges and builds
3.Solution configuration
4.Conduct unit testing
5.Develop system, integration, regression, UAT
test plans, production cutover plans
6.Set up test and training environments
7.Develop user training plans and
documentation
8.Develop release notes
1.Code unit tested
2.Test and production
cutover plans
3.Test environment
certification
4.User training plans
5.Release notes

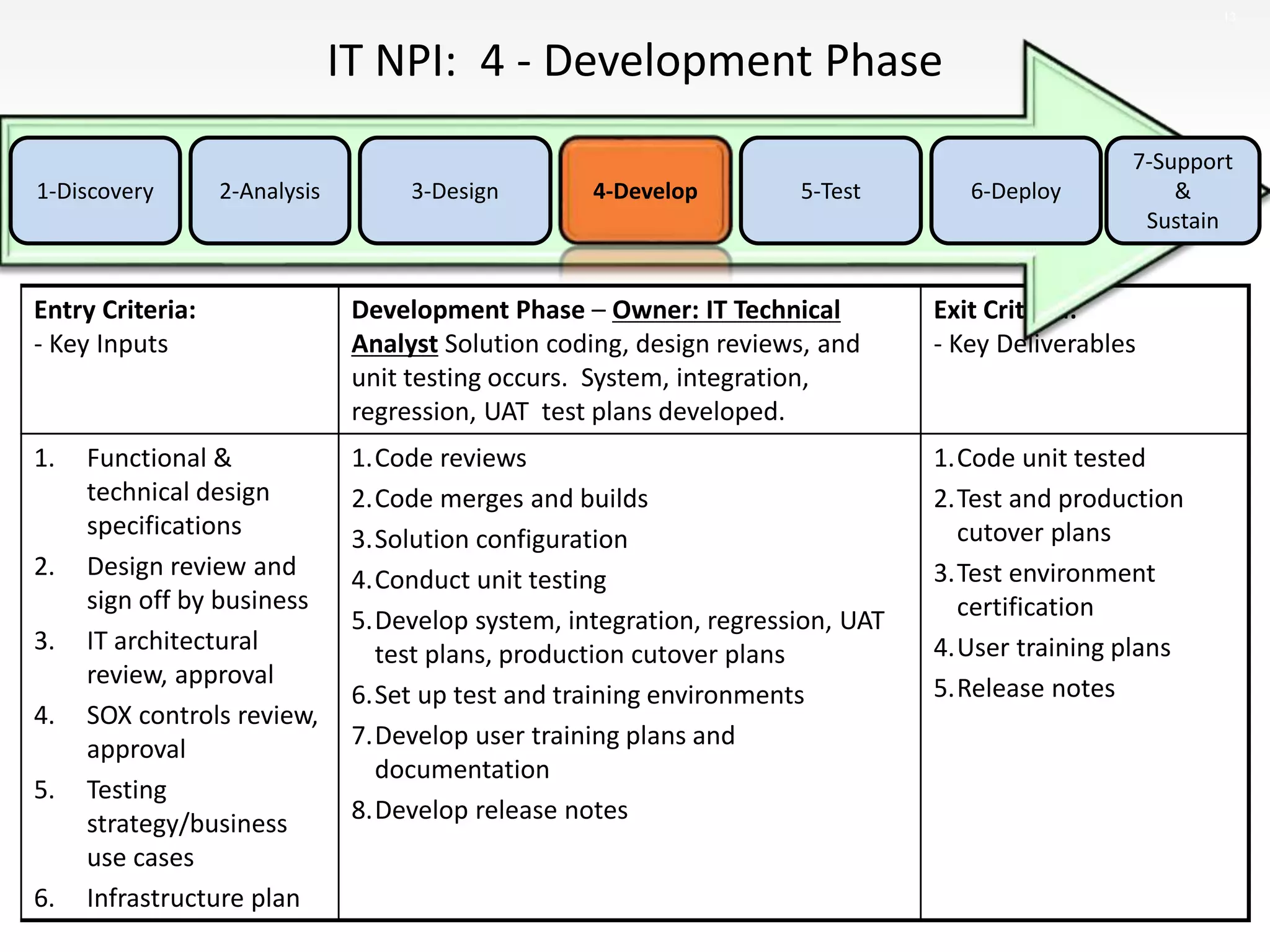

IT NPI: 4 - Development Phase
13
5-Test2-Analysis 3-Design1-Discovery 6-Deploy
7-Support
&
Sustain
4-Develop
14
Entry Criteria
- Key inputs

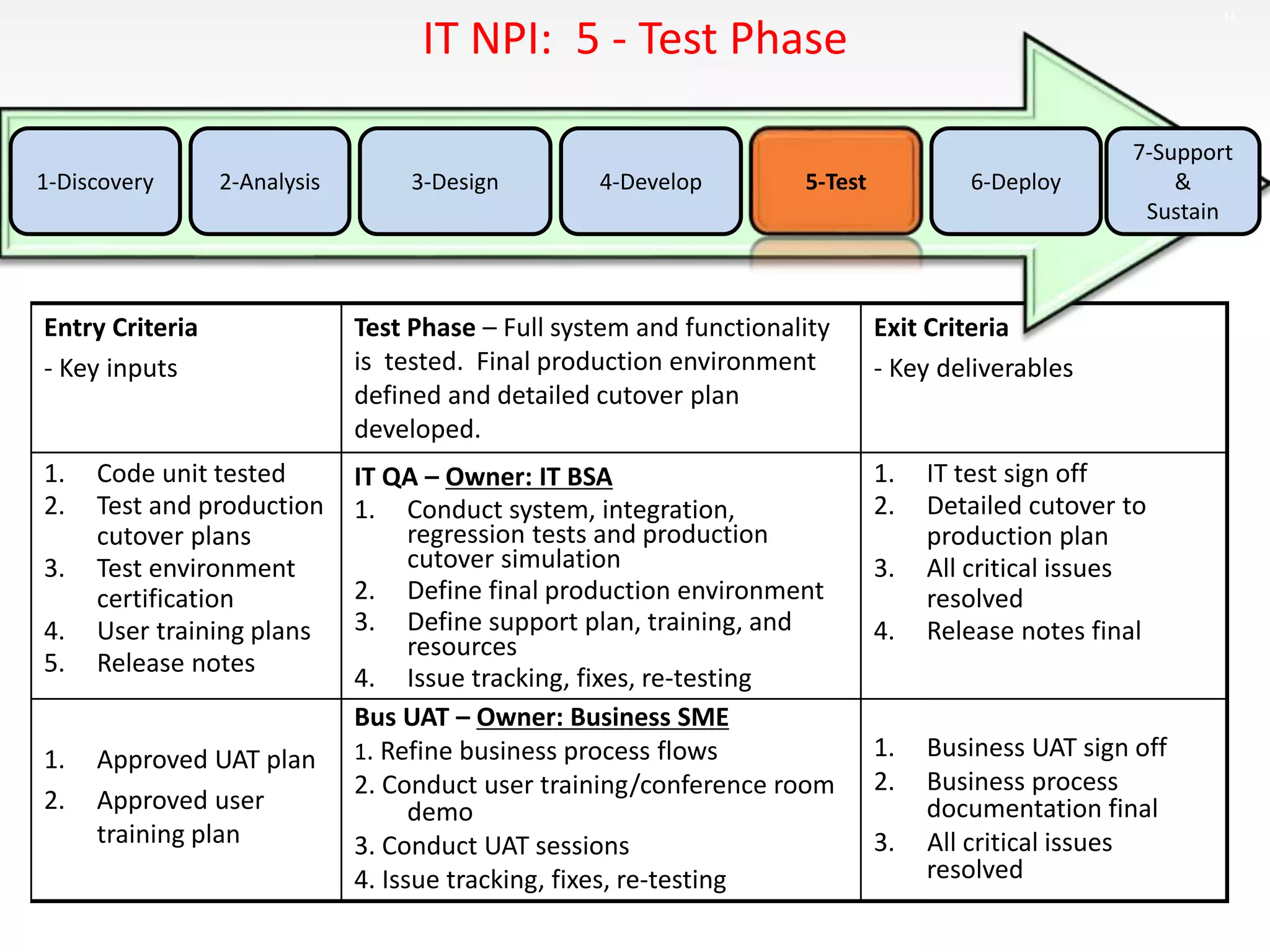

Test Phase – Full system and functionality
is tested. Final production environment
defined and detailed cutover plan
developed.
Exit Criteria
- Key deliverables
1. Code unit tested
2. Test and production
cutover plans
3. Test environment
certification
4. User training plans
5. Release notes
IT QA – Owner: IT BSA
1. Conduct system, integration,
regression tests and production
cutover simulation
2. Define final production environment
3. Define support plan, training, and
resources
4. Issue tracking, fixes, re-testing
1. IT test sign off
2. Detailed cutover to
production plan
3. All critical issues
resolved
4. Release notes final
1. Approved UAT plan
2. Approved user
training plan
Bus UAT – Owner: Business SME
1. Refine business process flows
2. Conduct user training/conference room
demo
3. Conduct UAT sessions
4. Issue tracking, fixes, re-testing
1. Business UAT sign off
2. Business process
documentation final
3. All critical issues
resolved
IT NPI: 5 - Test Phase
4-Develop2-Analysis 3-Design1-Discovery 6-Deploy
7-Support
&
Sustain
5-Test
Entry Criteria:
- Key inputs

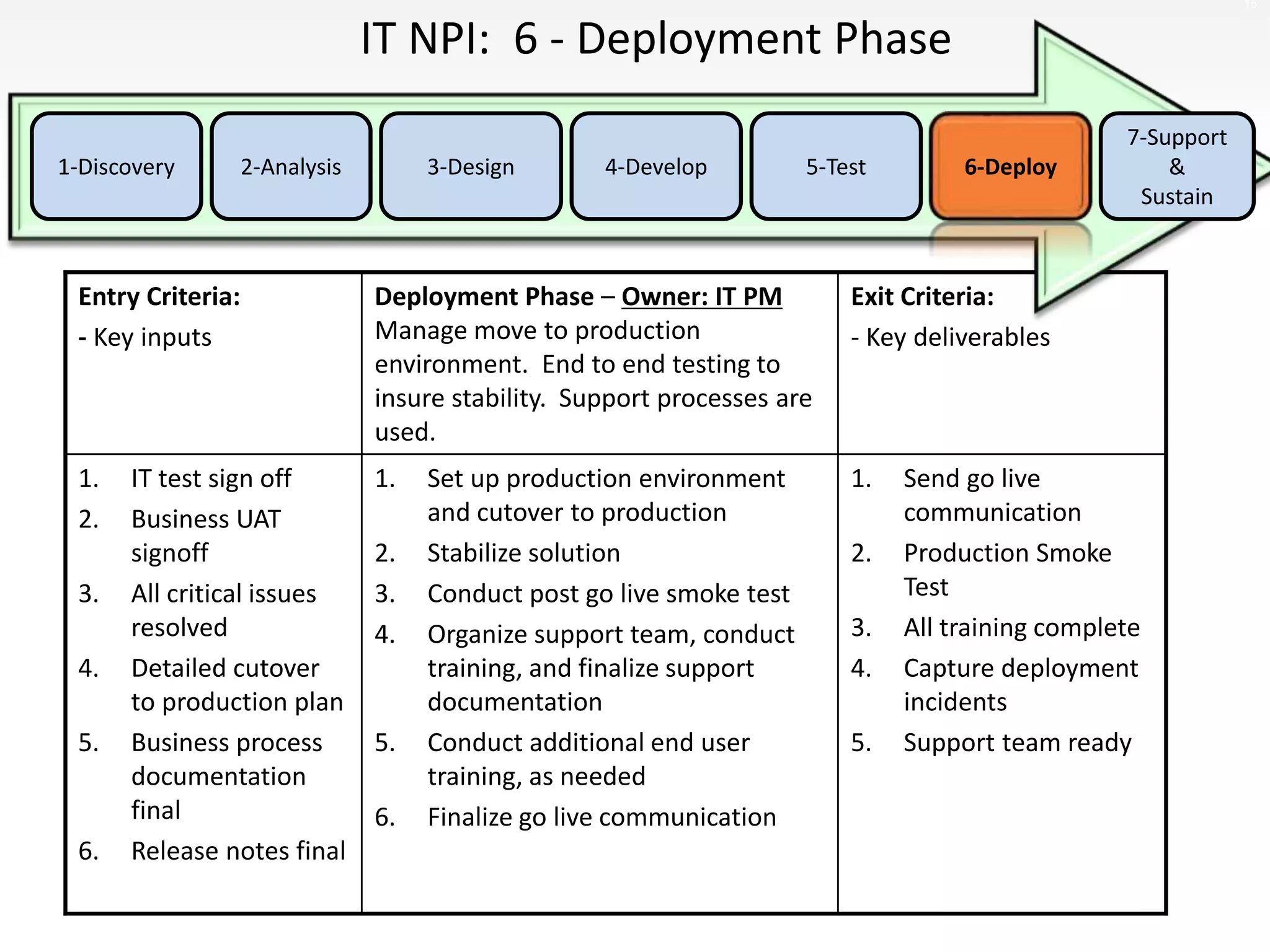

Deployment Phase – Owner: IT PM
Manage move to production
environment. End to end testing to
insure stability. Support processes are
used.
Exit Criteria:
- Key deliverables
1. IT test sign off
2. Business UAT
signoff
3. All critical issues
resolved
4. Detailed cutover
to production plan
5. Business process
documentation
final
6. Release notes final
1. Set up production environment
and cutover to production
2. Stabilize solution
3. Conduct post go live smoke test
4. Organize support team, conduct
training, and finalize support
documentation
5. Conduct additional end user
training, as needed
6. Finalize go live communication
1. Send go live
communication
2. Production Smoke
Test
3. All training complete
4. Capture deployment
incidents
5. Support team ready
IT NPI: 6 - Deployment Phase
15
5-Test2-Analysis 3-Design1-Discovery 4-Develop 6-Deploy
7-Support
&
Sustain
Entry Criteria
- Key inputs

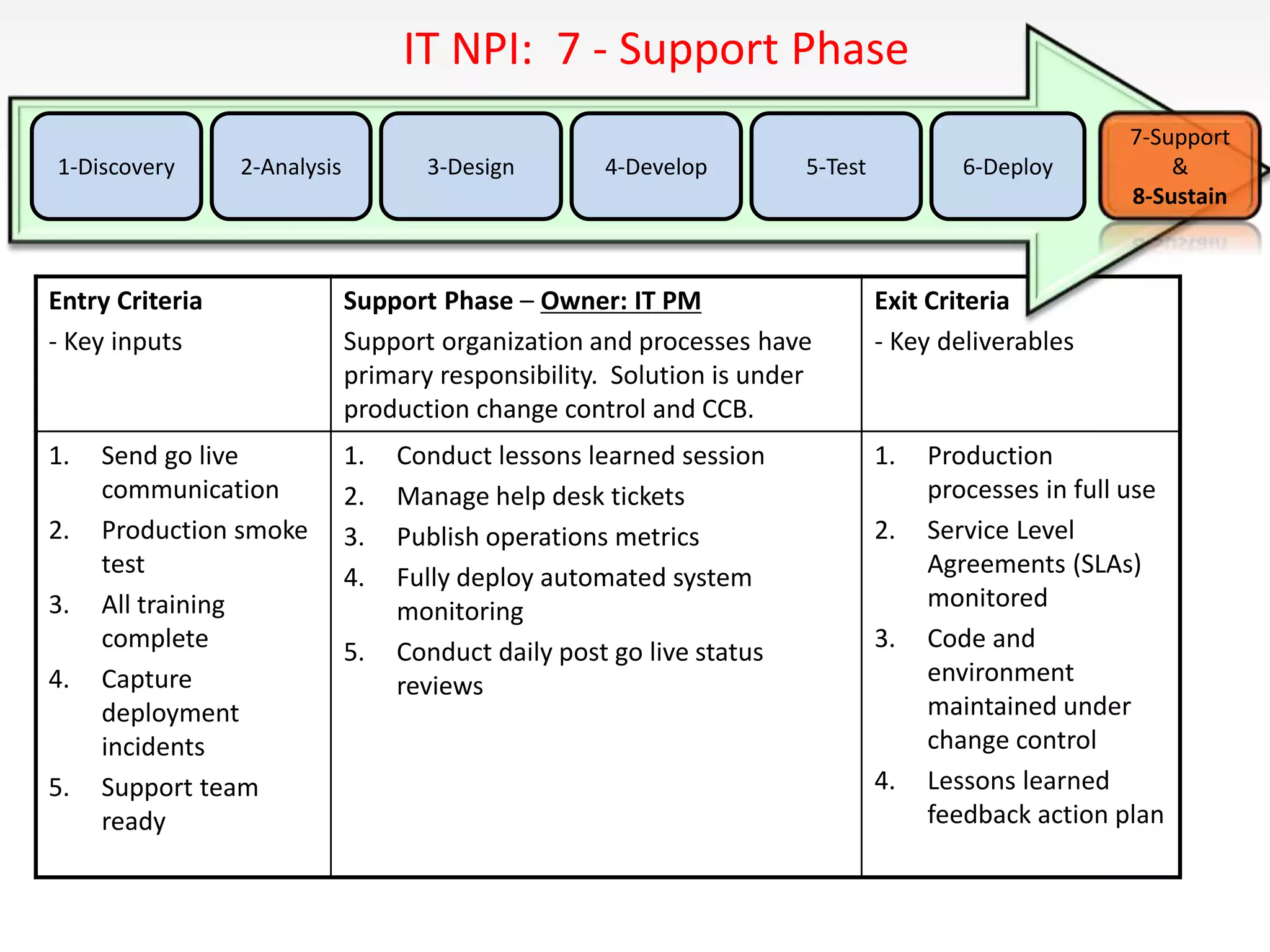

Support Phase – Owner: IT PM
Support organization and processes have
primary responsibility. Solution is under
production change control and CCB.
Exit Criteria
- Key deliverables
1. Send go live
communication
2. Production smoke
test
3. All training
complete
4. Capture
deployment
incidents
5. Support team
ready
1. Conduct lessons learned session
2. Manage help desk tickets
3. Publish operations metrics
4. Fully deploy automated system
monitoring
5. Conduct daily post go live status
reviews
1. Production
processes in full use
2. Service Level
Agreements (SLAs)
monitored
3. Code and
environment
maintained under
change control
4. Lessons learned
feedback action plan
IT NPI: 7 - Support Phase
5-Test2-Analysis 3-Design1-Discovery 4-Develop 6-Deploy
7-Support
&
8-Sustain

Team Roles and Responsibilities
• Estimate time required from project resources and get
commitment from management
• Have clearly defined roles and responsibilities for team
members
– efficient decision making
– no gaps in project delivery
• Involve business stakeholders up front, at Discovery Phase
• provide clarity and thoroughness of business requirements
• IT BSA and IT Management Sponsor must be involved up
front, at Discovery Phase
• work closely with the business to understand the
problem/opportunity and provide clear functional
requirements for the design phase
18

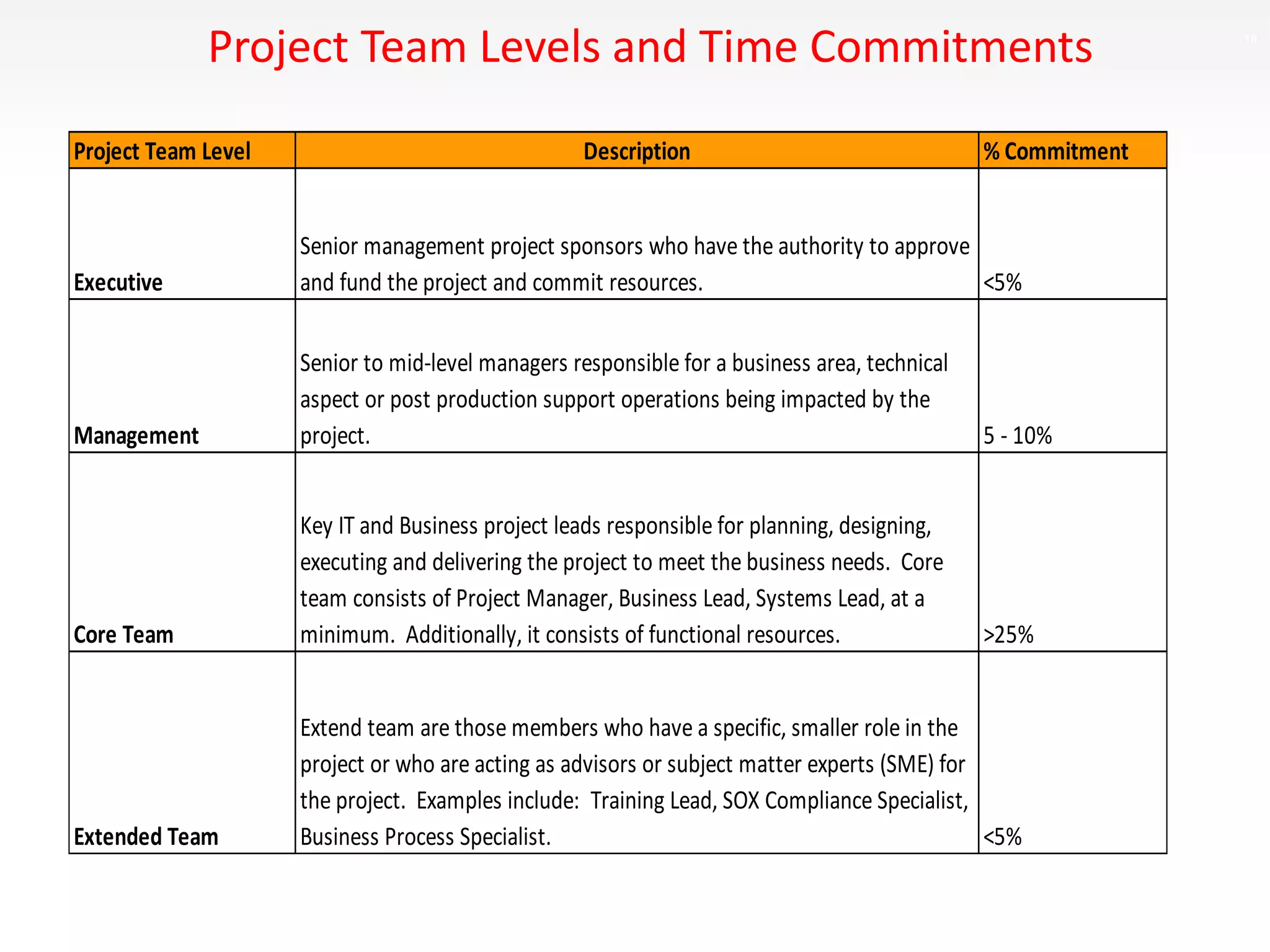

Project Team Level Description % Commitment
Executive
Senior management project sponsors who have the authority to approve
and fund the project and commit resources. <5%
Management
Senior to mid-level managers responsible for a business area, technical
aspect or post production support operations being impacted by the
project. 5 - 10%
Core Team
Key IT and Business project leads responsible for planning, designing,
executing and delivering the project to meet the business needs. Core
team consists of Project Manager, Business Lead, Systems Lead, at a
minimum. Additionally, it consists of functional resources. >25%
Extended Team
Extend team are those members who have a specific, smaller role in the
project or who are acting as advisors or subject matter experts (SME) for
the project. Examples include: Training Lead, SOX Compliance Specialist,
Business Process Specialist. <5%
Project Team Levels and Time Commitments

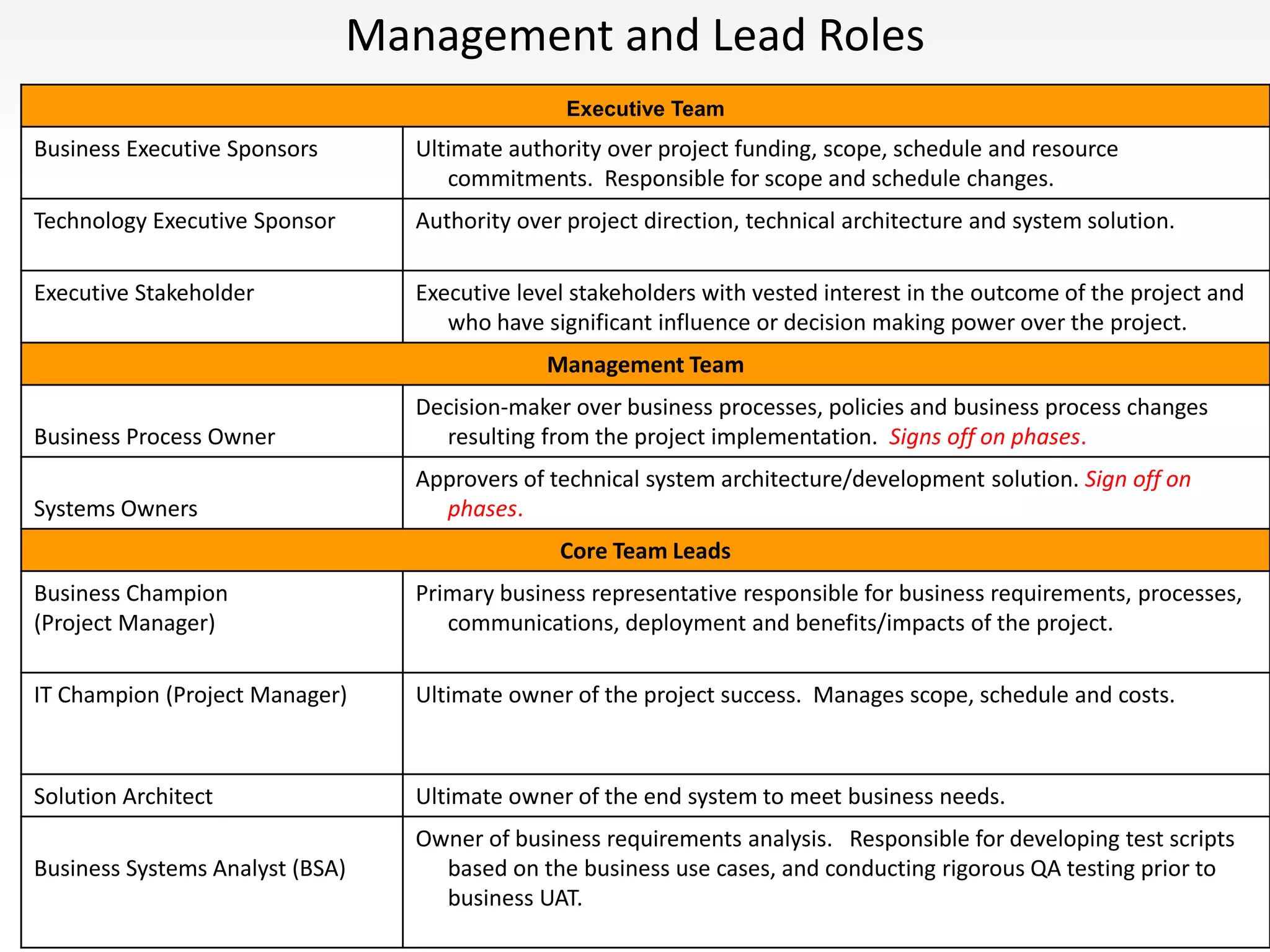

Management and Lead Roles
Executive Team
Business Executive Sponsors Ultimate authority over project funding, scope, schedule and resource
commitments. Responsible for scope and schedule changes.
Technology Executive Sponsor Authority over project direction, technical architecture and system solution.
Executive Stakeholder Executive level stakeholders with vested interest in the outcome of the project and
who have significant influence or decision making power over the project.
Management Team
Business Process Owner
Decision-maker over business processes, policies and business process changes
resulting from the project implementation. Signs off on phases.
Systems Owners
Approvers of technical system architecture/development solution. Sign off on
phases.
Core Team Leads
Business Champion
(Project Manager)
Primary business representative responsible for business requirements, processes,
communications, deployment and benefits/impacts of the project.
IT Champion (Project Manager) Ultimate owner of the project success. Manages scope, schedule and costs.
Solution Architect Ultimate owner of the end system to meet business needs.
Business Systems Analyst (BSA)
Owner of business requirements analysis. Responsible for developing test scripts
based on the business use cases, and conducting rigorous QA testing prior to
business UAT.
Core and Extended Team

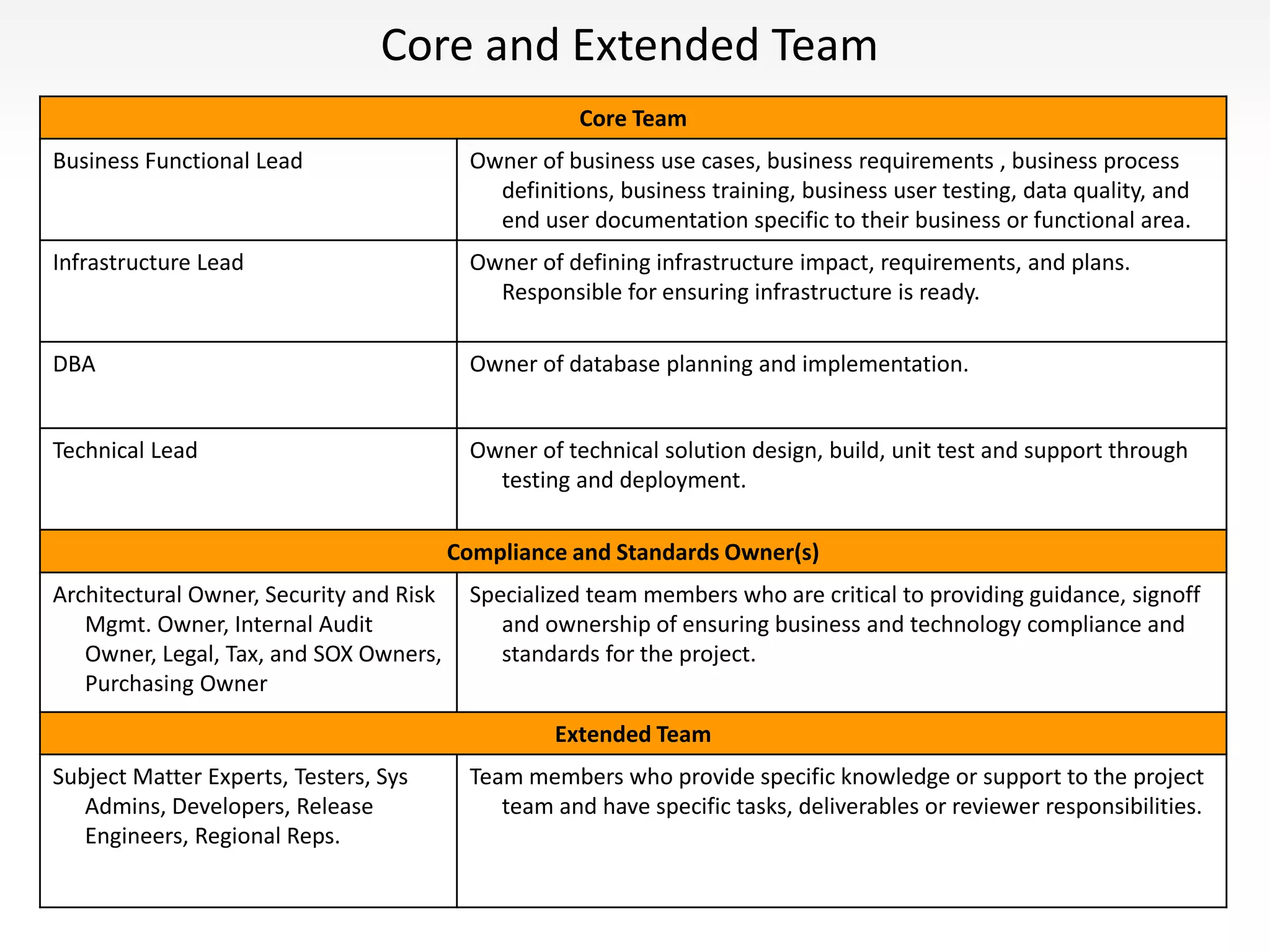

Core Team
Business Functional Lead Owner of business use cases, business requirements , business process
definitions, business training, business user testing, data quality, and
end user documentation specific to their business or functional area.
Infrastructure Lead Owner of defining infrastructure impact, requirements, and plans.
Responsible for ensuring infrastructure is ready.
DBA Owner of database planning and implementation.
Technical Lead Owner of technical solution design, build, unit test and support through
testing and deployment.
Compliance and Standards Owner(s)
Architectural Owner, Security and Risk
Mgmt. Owner, Internal Audit
Owner, Legal, Tax, and SOX Owners,
Purchasing Owner
Specialized team members who are critical to providing guidance, signoff
and ownership of ensuring business and technology compliance and
standards for the project.
Extended Team
Subject Matter Experts, Testers, Sys
Admins, Developers, Release
Engineers, Regional Reps.
Team members who provide specific knowledge or support to the project
team and have specific tasks, deliverables or reviewer responsibilities.

NPI Process Documentation
• Use the phase process templates to capture and communicate project
information
– Clarity of information across a multi-functional team – ‘1 source of
information’
– Gets people on ‘the same page’
– Facilitates phase sign offs and commitment
– Strengthens Business/IT interlock
• Documents are currently stored on the network drive
– Each project should set up folders on the share drive to store project
documents and project correspondence
– Templates and/or examples are provided for each phase
NPI Process (link to all NPI Process material)

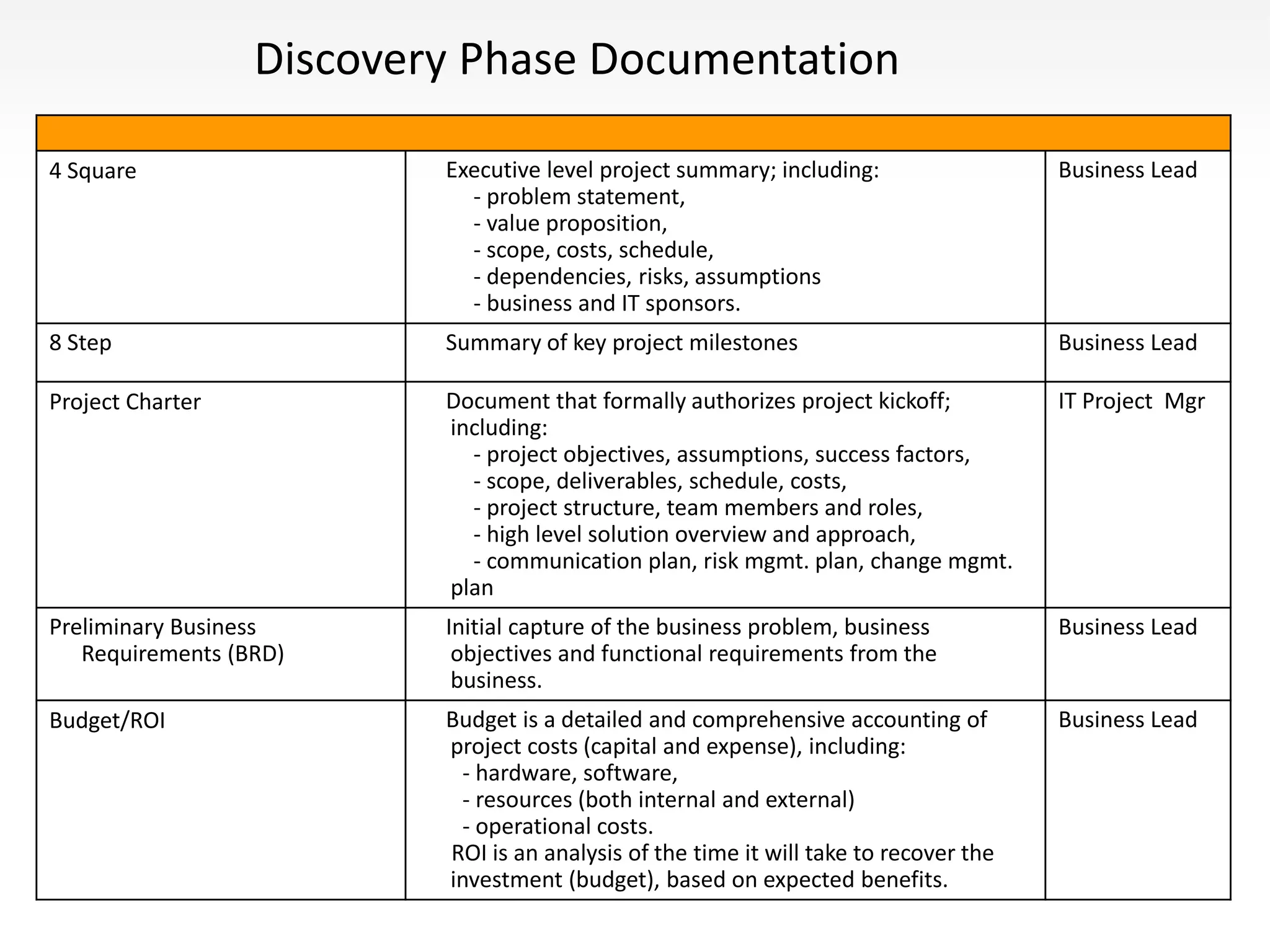

Discovery Phase Documentation
4 Square Executive level project summary; including:
- problem statement,
- value proposition,
- scope, costs, schedule,
- dependencies, risks, assumptions
- business and IT sponsors.
Business Lead
8 Step Summary of key project milestones Business Lead
Project Charter Document that formally authorizes project kickoff;
including:
- project objectives, assumptions, success factors,
- scope, deliverables, schedule, costs,
- project structure, team members and roles,
- high level solution overview and approach,
- communication plan, risk mgmt. plan, change mgmt.
plan
IT Project Mgr
Preliminary Business
Requirements (BRD)
Initial capture of the business problem, business
objectives and functional requirements from the
business.
Business Lead
Budget/ROI Budget is a detailed and comprehensive accounting of
project costs (capital and expense), including:
- hardware, software,
- resources (both internal and external)
- operational costs.
ROI is an analysis of the time it will take to recover the
investment (budget), based on expected benefits.
Business Lead

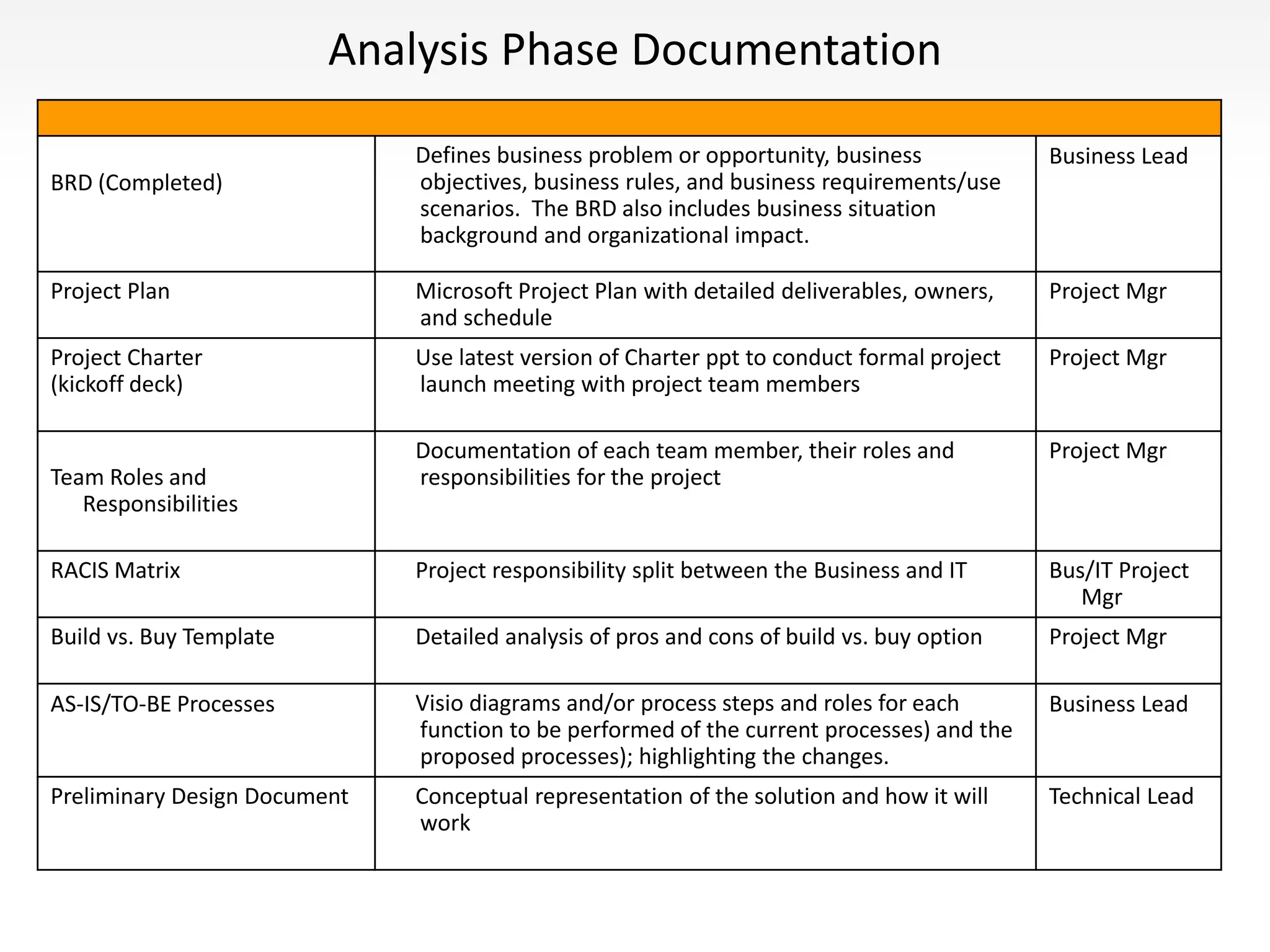

Analysis Phase Documentation
BRD (Completed)
Defines business problem or opportunity, business
objectives, business rules, and business requirements/use
scenarios. The BRD also includes business situation
background and organizational impact.
Business Lead
Project Plan Microsoft Project Plan with detailed deliverables, owners,
and schedule
Project Mgr
Project Charter
(kickoff deck)
Use latest version of Charter ppt to conduct formal project
launch meeting with project team members
Project Mgr
Team Roles and
Responsibilities
Documentation of each team member, their roles and
responsibilities for the project
Project Mgr
RACIS Matrix Project responsibility split between the Business and IT Bus/IT Project
Mgr
Build vs. Buy Template Detailed analysis of pros and cons of build vs. buy option Project Mgr
AS-IS/TO-BE Processes Visio diagrams and/or process steps and roles for each
function to be performed of the current processes) and the
proposed processes); highlighting the changes.
Business Lead
Preliminary Design Document Conceptual representation of the solution and how it will
work
Technical Lead

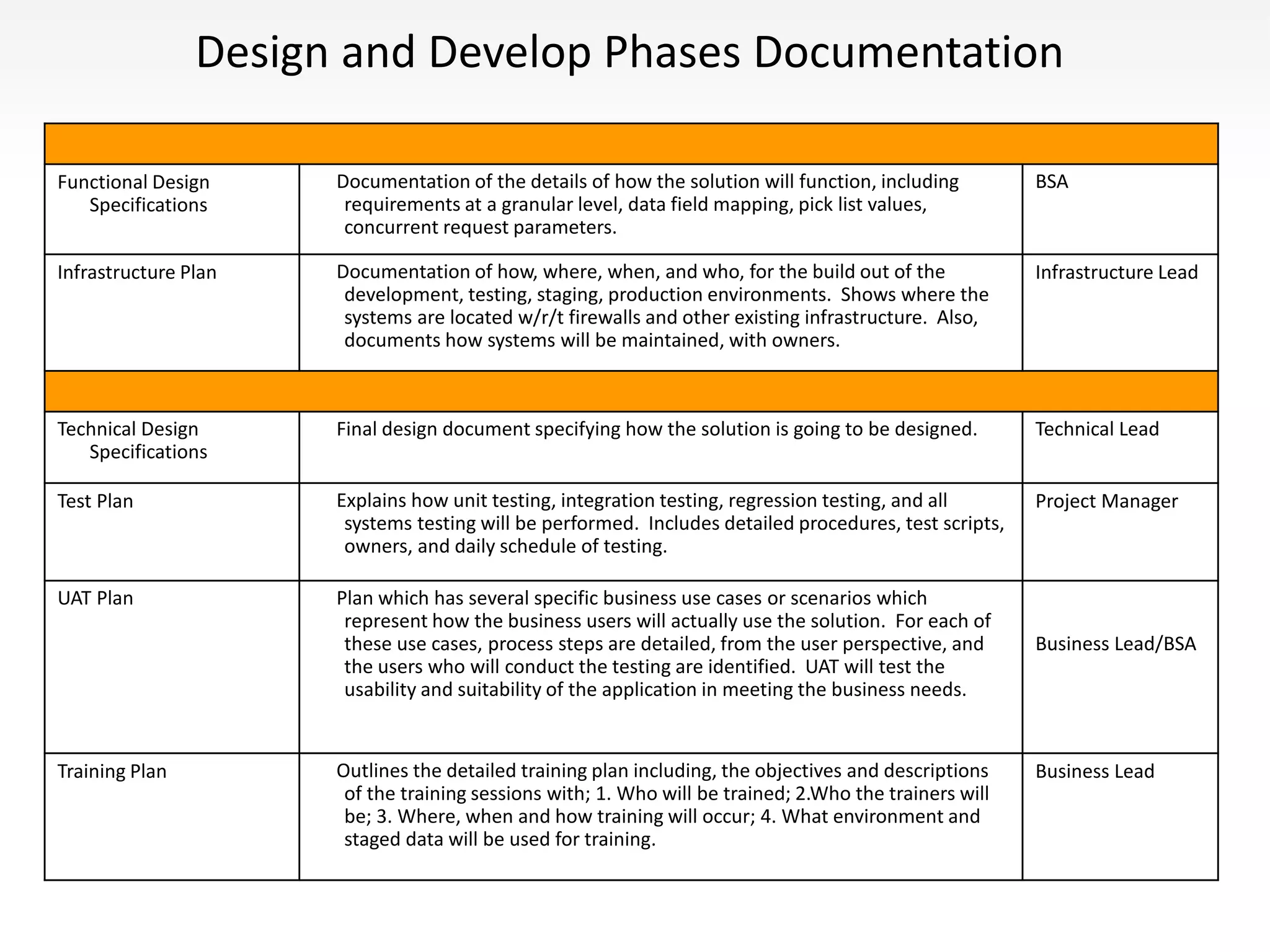

Design and Develop Phases Documentation
Functional Design
Specifications
Documentation of the details of how the solution will function, including
requirements at a granular level, data field mapping, pick list values,
concurrent request parameters.
BSA
Infrastructure Plan Documentation of how, where, when, and who, for the build out of the
development, testing, staging, production environments. Shows where the
systems are located w/r/t firewalls and other existing infrastructure. Also,
documents how systems will be maintained, with owners.
Infrastructure Lead
Technical Design
Specifications
Final design document specifying how the solution is going to be designed. Technical Lead
Test Plan Explains how unit testing, integration testing, regression testing, and all
systems testing will be performed. Includes detailed procedures, test scripts,
owners, and daily schedule of testing.
Project Manager
UAT Plan Plan which has several specific business use cases or scenarios which
represent how the business users will actually use the solution. For each of
these use cases, process steps are detailed, from the user perspective, and
the users who will conduct the testing are identified. UAT will test the
usability and suitability of the application in meeting the business needs.
Business Lead/BSA
Training Plan Outlines the detailed training plan including, the objectives and descriptions
of the training sessions with; 1. Who will be trained; 2.Who the trainers will
be; 3. Where, when and how training will occur; 4. What environment and
staged data will be used for training.
Business Lead

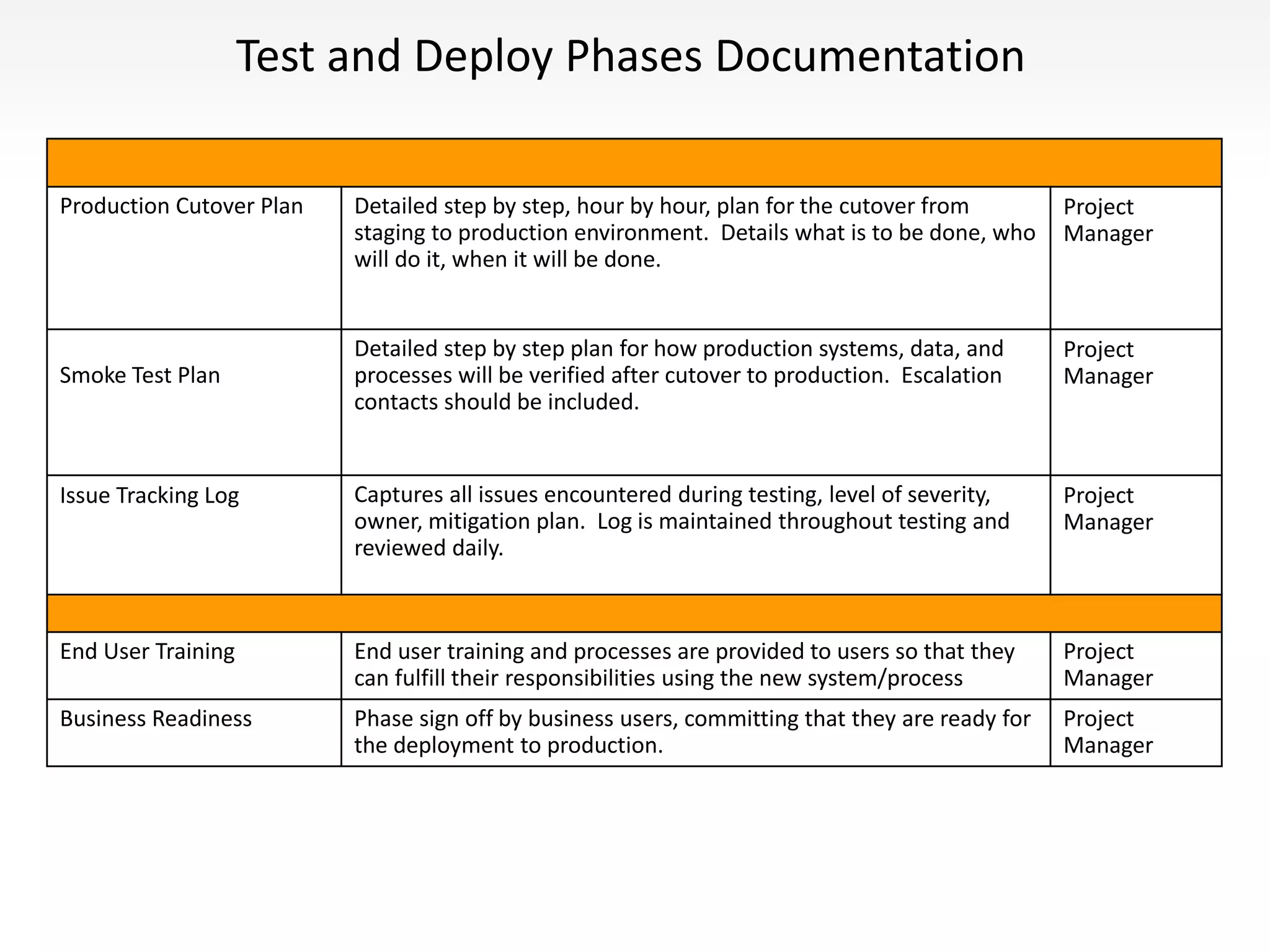

Test and Deploy Phases Documentation
Production Cutover Plan Detailed step by step, hour by hour, plan for the cutover from
staging to production environment. Details what is to be done, who
will do it, when it will be done.
Project
Manager
Smoke Test Plan
Detailed step by step plan for how production systems, data, and
processes will be verified after cutover to production. Escalation
contacts should be included.
Project
Manager
Issue Tracking Log Captures all issues encountered during testing, level of severity,
owner, mitigation plan. Log is maintained throughout testing and
reviewed daily.
Project
Manager
End User Training End user training and processes are provided to users so that they
can fulfill their responsibilities using the new system/process
Project
Manager
Business Readiness Phase sign off by business users, committing that they are ready for
the deployment to production.
Project
Manager
Support Phase Documentation
Post Deployment Support For the first month after the release to production, IT
conducts daily checkpoint meetings with business to monitor
the application performance and track/resolve issues.
Enhancement requests are captured for consideration in the
future releases.
Project Mgr
Lesson Learned Documentation of the project outcomes of what worked and
what didn't work. Includes improvement recommendations.
Ultimately, this document is converted to an action plan with
owners and timeframes.
Project Mgr
Change Control Request
process and form
This process captures change requests from the business
after the project has already begun. These requests are
reviewed and assessed for inclusion in the current release or
a subsequent release. After the Design Phase, all change
requests require the signature of an executive.
Support Mgr

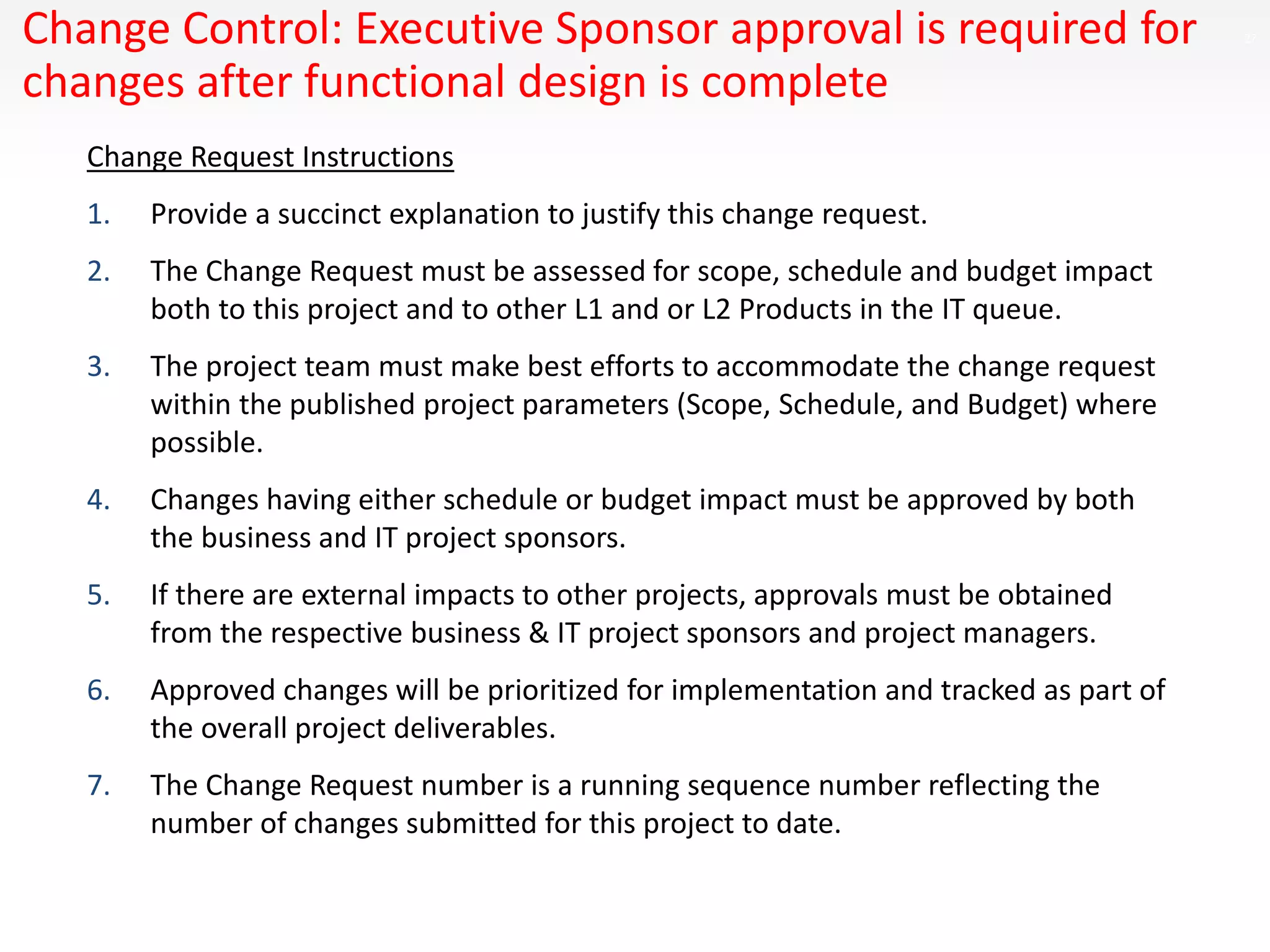

27Change Control: Executive Sponsor approval is required for
changes after functional design is complete
Change Request Instructions
1. Provide a succinct explanation to justify this change request.
2. The Change Request must be assessed for scope, schedule and budget impact
both to this project and to other L1 and or L2 Products in the IT queue.
3. The project team must make best efforts to accommodate the change request
within the published project parameters (Scope, Schedule, and Budget) where
possible.
4. Changes having either schedule or budget impact must be approved by both
the business and IT project sponsors.
5. If there are external impacts to other projects, approvals must be obtained
from the respective business & IT project sponsors and project managers.
6. Approved changes will be prioritized for implementation and tracked as part of
the overall project deliverables.
7. The Change Request number is a running sequence number reflecting the
number of changes submitted for this project to date.
28
© 2006 RIVERBED TECHNOLOGY, INC – CONFIDENTIAL
Page : 28
Change Request Form Ref Nbr: 001
Project: HRIS – SS Implementation Date: 08/12/16
Description:
Additional time is required to re-engineer and gather
requirements for providing Absence Management,
including accrual tracking, within the Self Service
functions.
Business Benefits:
Provide global absence tracking, accruals and reporting
from single source system.
Impact if not implemented:
 No centralized tracking of employee absences.
Alternatives:
 None
Project Impact:
1.Schedule: No Change to Go Live date.
2.Budget: $25,000 increase for T&M.
3.Cross Functional impact: N
Approvals:
1.Project Steering Committee: Date: 08/15/16
2.Project Sponsor : Date: 08/15/16
3.Cross Functional Business/IT PMs :Date: 08/15/16
Comments:

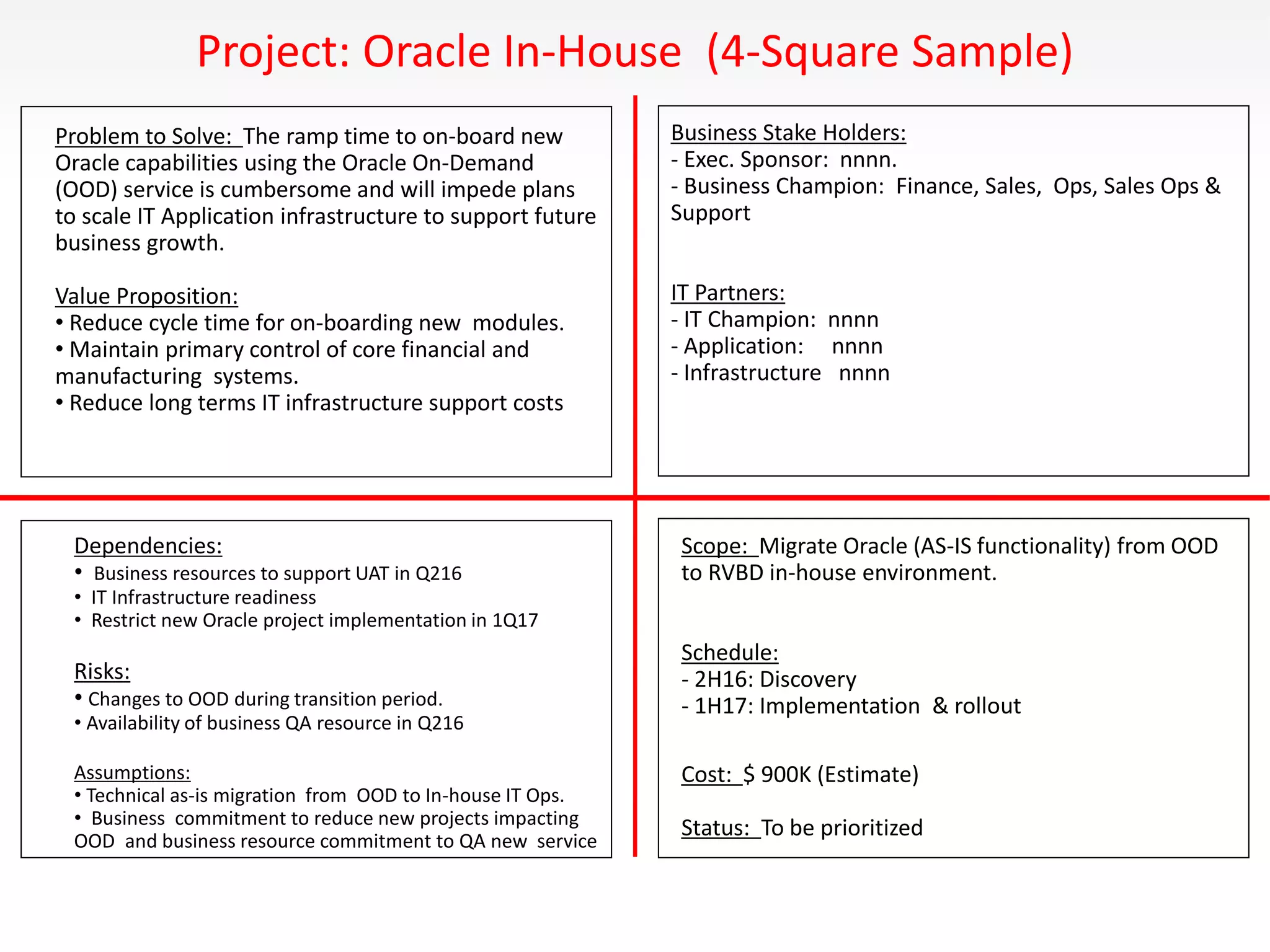

Project: Oracle In-House (4-Square Sample)
Problem to Solve: The ramp time to on-board new
Oracle capabilities using the Oracle On-Demand
(OOD) service is cumbersome and will impede plans
to scale IT Application infrastructure to support future
business growth.
Value Proposition:
• Reduce cycle time for on-boarding new modules.
• Maintain primary control of core financial and
manufacturing systems.
• Reduce long terms IT infrastructure support costs
Business Stake Holders:
- Exec. Sponsor: nnnn.
- Business Champion: Finance, Sales, Ops, Sales Ops &
Support
IT Partners:
- IT Champion: nnnn
- Application: nnnn
- Infrastructure nnnn
Dependencies:
• Business resources to support UAT in Q216
• IT Infrastructure readiness
• Restrict new Oracle project implementation in 1Q17
Risks:
• Changes to OOD during transition period.
• Availability of business QA resource in Q216
Assumptions:
• Technical as-is migration from OOD to In-house IT Ops.
• Business commitment to reduce new projects impacting
OOD and business resource commitment to QA new service
Scope: Migrate Oracle (AS-IS functionality) from OOD
to RVBD in-house environment.
Schedule:
- 2H16: Discovery
- 1H17: Implementation & rollout
Cost: $ 900K (Estimate)
Status: To be prioritized
Thank you

More Related Content

What's hot

Training ppt for control plan
Training ppt for control plan   Training ppt for control plan
Training ppt for control plan Jitesh Gaurav

Value Stream Mapping -The Concept
Value Stream Mapping -The ConceptValue Stream Mapping -The Concept
Value Stream Mapping -The ConceptSubhrajyoti Parida

Kaizen Events Blitz & Lean Projects
Kaizen Events   Blitz  & Lean ProjectsKaizen Events   Blitz  & Lean Projects
Kaizen Events Blitz & Lean ProjectsAnand Subramaniam

UCSD Class: Lean Office
UCSD Class: Lean OfficeUCSD Class: Lean Office
UCSD Class: Lean OfficeTKMG, Inc.

Value Stream Mapping
Value Stream MappingValue Stream Mapping
Value Stream Mappingmahawar1987

List of mandatory IATF 16949 documents
List of mandatory IATF 16949 documents List of mandatory IATF 16949 documents
List of mandatory IATF 16949 documents Global Manager Group

APQP Training presentation
APQP Training  presentationAPQP Training  presentation
APQP Training presentationQualsys Ltd

Lean Manufacturing and Ergonomic Workcell Design
Lean Manufacturing and Ergonomic Workcell DesignLean Manufacturing and Ergonomic Workcell Design
Lean Manufacturing and Ergonomic Workcell DesignCMA/Flodyne/Hydradyne

Gap analysis for IATF 16949 2016
Gap analysis for IATF 16949 2016Gap analysis for IATF 16949 2016
Gap analysis for IATF 16949 2016Amit Mishra

Value Stream Mapping in Office & Service Setttings
Value Stream Mapping in Office & Service SetttingsValue Stream Mapping in Office & Service Setttings
Value Stream Mapping in Office & Service SetttingsTKMG, Inc.

Delivery Excellence
Delivery Excellence Delivery Excellence
Delivery Excellence jkw900

How to Introduce Operational Excellence in your Organisation?
How to Introduce Operational Excellence in your Organisation?How to Introduce Operational Excellence in your Organisation?
How to Introduce Operational Excellence in your Organisation?Tina Arora

Ian's 7 wastes of production
Ian's 7 wastes of productionIan's 7 wastes of production
Ian's 7 wastes of productionIan Timm

What's hot (20)

Training ppt for control plan
Training ppt for control plan   Training ppt for control plan
Training ppt for control plan

Apqp fundamentals
Apqp fundamentalsApqp fundamentals
Apqp fundamentals

Value Stream Mapping -The Concept
Value Stream Mapping -The ConceptValue Stream Mapping -The Concept
Value Stream Mapping -The Concept

Kaizen Events Blitz & Lean Projects
Kaizen Events   Blitz  & Lean ProjectsKaizen Events   Blitz  & Lean Projects
Kaizen Events Blitz & Lean Projects

UCSD Class: Lean Office
UCSD Class: Lean OfficeUCSD Class: Lean Office
UCSD Class: Lean Office

Process mapping overview
Process mapping overviewProcess mapping overview
Process mapping overview

Value Stream Mapping
Value Stream MappingValue Stream Mapping
Value Stream Mapping

Introduction To Lean
Introduction To LeanIntroduction To Lean
Introduction To Lean

Lean Office by Operational Excellence Consulting
Lean Office by Operational Excellence ConsultingLean Office by Operational Excellence Consulting
Lean Office by Operational Excellence Consulting

List of mandatory IATF 16949 documents
List of mandatory IATF 16949 documents List of mandatory IATF 16949 documents
List of mandatory IATF 16949 documents

APQP Training presentation
APQP Training  presentationAPQP Training  presentation
APQP Training presentation

Lean Manufacturing and Ergonomic Workcell Design
Lean Manufacturing and Ergonomic Workcell DesignLean Manufacturing and Ergonomic Workcell Design
Lean Manufacturing and Ergonomic Workcell Design

Gap analysis for IATF 16949 2016
Gap analysis for IATF 16949 2016Gap analysis for IATF 16949 2016
Gap analysis for IATF 16949 2016

APQP
APQPAPQP
APQP

Value Stream Mapping in Office & Service Setttings
Value Stream Mapping in Office & Service SetttingsValue Stream Mapping in Office & Service Setttings
Value Stream Mapping in Office & Service Setttings

Delivery Excellence
Delivery Excellence Delivery Excellence
Delivery Excellence

How to Introduce Operational Excellence in your Organisation?
How to Introduce Operational Excellence in your Organisation?How to Introduce Operational Excellence in your Organisation?
How to Introduce Operational Excellence in your Organisation?

Dwm ppt
Dwm pptDwm ppt
Dwm ppt

Ian's 7 wastes of production
Ian's 7 wastes of productionIan's 7 wastes of production
Ian's 7 wastes of production

APQP
APQP APQP
APQP

Viewers also liked

Stage gate innovation decision making new product development strategy screen...
Stage gate innovation decision making new product development strategy screen...Stage gate innovation decision making new product development strategy screen...
Stage gate innovation decision making new product development strategy screen...SlideTeam.net

Innovation decision making new product development strategy style design 2 po...
Innovation decision making new product development strategy style design 2 po...Innovation decision making new product development strategy style design 2 po...
Innovation decision making new product development strategy style design 2 po...SlideTeam.net

Technology Flow Chart, Professional Development, And Action Plan
Technology Flow Chart, Professional Development, And Action PlanTechnology Flow Chart, Professional Development, And Action Plan
Technology Flow Chart, Professional Development, And Action PlanBianca Darley

New product development strategy style 4 powerpoint presentation templates
New product development strategy style 4 powerpoint presentation templatesNew product development strategy style 4 powerpoint presentation templates
New product development strategy style 4 powerpoint presentation templatesSlideTeam.net

New product development strategy 1 powerpoint presentation templates
New product development strategy 1 powerpoint presentation templatesNew product development strategy 1 powerpoint presentation templates
New product development strategy 1 powerpoint presentation templatesSlideTeam.net

Key to Successful Design to Manufacturing - Siddharth Desai, I-Flow Corporation
Key to Successful Design to Manufacturing - Siddharth Desai, I-Flow CorporationKey to Successful Design to Manufacturing - Siddharth Desai, I-Flow Corporation
Key to Successful Design to Manufacturing - Siddharth Desai, I-Flow Corporationmarcus evans Network

Product Design & Process Selection Manufacturing
Product Design & Process Selection  ManufacturingProduct Design & Process Selection  Manufacturing
Product Design & Process Selection Manufacturingwizkidrx

New product development strategy style 5 powerpoint presentation templates
New product development strategy style 5 powerpoint presentation templatesNew product development strategy style 5 powerpoint presentation templates
New product development strategy style 5 powerpoint presentation templatesSlideTeam.net

Project Management in Agile Organizations - Stage Gate and Agile
Project Management in Agile Organizations - Stage Gate and AgileProject Management in Agile Organizations - Stage Gate and Agile
Project Management in Agile Organizations - Stage Gate and AgileKnowit_TM

New product development ppt slides
New product development ppt slidesNew product development ppt slides
New product development ppt slidesYodhia Antariksa

Innovation product design planning process style 5 powerpoint presentation te...
Innovation product design planning process style 5 powerpoint presentation te...Innovation product design planning process style 5 powerpoint presentation te...
Innovation product design planning process style 5 powerpoint presentation te...SlideTeam.net

Product Development Process Diagram
Product Development Process Diagram Product Development Process Diagram
Product Development Process Diagram Demand Metric

Demand Forecasting
Demand ForecastingDemand Forecasting
Demand Forecastingyashpal01

Brand first, branding second
Brand first, branding secondBrand first, branding second
Brand first, branding secondGordon Graham

New Product Development Strategy
New Product Development StrategyNew Product Development Strategy
New Product Development StrategyYodhia Antariksa

3 Things Every Sales Team Needs to Be Thinking About in 2017
3 Things Every Sales Team Needs to Be Thinking About in 20173 Things Every Sales Team Needs to Be Thinking About in 2017
3 Things Every Sales Team Needs to Be Thinking About in 2017Drift

Viewers also liked (18)

Stage gate innovation decision making new product development strategy screen...
Stage gate innovation decision making new product development strategy screen...Stage gate innovation decision making new product development strategy screen...
Stage gate innovation decision making new product development strategy screen...

Innovation decision making new product development strategy style design 2 po...
Innovation decision making new product development strategy style design 2 po...Innovation decision making new product development strategy style design 2 po...
Innovation decision making new product development strategy style design 2 po...

Technology Flow Chart, Professional Development, And Action Plan
Technology Flow Chart, Professional Development, And Action PlanTechnology Flow Chart, Professional Development, And Action Plan
Technology Flow Chart, Professional Development, And Action Plan

New product development strategy style 4 powerpoint presentation templates
New product development strategy style 4 powerpoint presentation templatesNew product development strategy style 4 powerpoint presentation templates
New product development strategy style 4 powerpoint presentation templates

New product development strategy 1 powerpoint presentation templates
New product development strategy 1 powerpoint presentation templatesNew product development strategy 1 powerpoint presentation templates
New product development strategy 1 powerpoint presentation templates

Key to Successful Design to Manufacturing - Siddharth Desai, I-Flow Corporation
Key to Successful Design to Manufacturing - Siddharth Desai, I-Flow CorporationKey to Successful Design to Manufacturing - Siddharth Desai, I-Flow Corporation
Key to Successful Design to Manufacturing - Siddharth Desai, I-Flow Corporation

Balanced Scorecard
Balanced ScorecardBalanced Scorecard
Balanced Scorecard

Product Design & Process Selection Manufacturing
Product Design & Process Selection  ManufacturingProduct Design & Process Selection  Manufacturing
Product Design & Process Selection Manufacturing

New product development strategy style 5 powerpoint presentation templates
New product development strategy style 5 powerpoint presentation templatesNew product development strategy style 5 powerpoint presentation templates
New product development strategy style 5 powerpoint presentation templates

Project Management in Agile Organizations - Stage Gate and Agile
Project Management in Agile Organizations - Stage Gate and AgileProject Management in Agile Organizations - Stage Gate and Agile
Project Management in Agile Organizations - Stage Gate and Agile

New product development ppt slides
New product development ppt slidesNew product development ppt slides
New product development ppt slides

Innovation product design planning process style 5 powerpoint presentation te...
Innovation product design planning process style 5 powerpoint presentation te...Innovation product design planning process style 5 powerpoint presentation te...
Innovation product design planning process style 5 powerpoint presentation te...

Product Development Process Diagram
Product Development Process Diagram Product Development Process Diagram
Product Development Process Diagram

NPD- Stage Gate Presentation
NPD- Stage Gate PresentationNPD- Stage Gate Presentation
NPD- Stage Gate Presentation

Demand Forecasting
Demand ForecastingDemand Forecasting
Demand Forecasting

Brand first, branding second
Brand first, branding secondBrand first, branding second
Brand first, branding second

New Product Development Strategy
New Product Development StrategyNew Product Development Strategy
New Product Development Strategy

3 Things Every Sales Team Needs to Be Thinking About in 2017
3 Things Every Sales Team Needs to Be Thinking About in 20173 Things Every Sales Team Needs to Be Thinking About in 2017
3 Things Every Sales Team Needs to Be Thinking About in 2017

Similar to IT NPI Process

Good IT Project Management
Good IT Project Management Good IT Project Management
Good IT Project Management William Francis

Training on ASAP Methodology.ppt
Training on ASAP Methodology.pptTraining on ASAP Methodology.ppt
Training on ASAP Methodology.pptAshwaniKumar207236

Training on ASAP Methodology_11.10.2020.ppt
Training on ASAP Methodology_11.10.2020.pptTraining on ASAP Methodology_11.10.2020.ppt
Training on ASAP Methodology_11.10.2020.pptAshwaniKumar207236

2014 sdlc project and gate process rollout published v6
2014 sdlc project and gate process rollout   published v62014 sdlc project and gate process rollout   published v6
2014 sdlc project and gate process rollout published v6Jayne Edwards

eCIO PPT Roles for a SAP and Systems Integration Project
eCIO PPT Roles for a SAP and Systems Integration ProjecteCIO PPT Roles for a SAP and Systems Integration Project
eCIO PPT Roles for a SAP and Systems Integration ProjectDavid Niles

Discovering New Product Introduction using Autodesk PLM 360 – Rodney Coffey, ...
Discovering New Product Introduction using Autodesk PLM 360 – Rodney Coffey, ...Discovering New Product Introduction using Autodesk PLM 360 – Rodney Coffey, ...
Discovering New Product Introduction using Autodesk PLM 360 – Rodney Coffey, ...Synergis Engineering Design Solutions

Discovering New Product Introduction (NPI) using Autodesk Fusion Lifecycle
Discovering New Product Introduction (NPI) using Autodesk Fusion LifecycleDiscovering New Product Introduction (NPI) using Autodesk Fusion Lifecycle
Discovering New Product Introduction (NPI) using Autodesk Fusion LifecycleRazorleaf Corporation

All About Business Analyst Becoming a successful BA
All About Business Analyst Becoming a successful BAAll About Business Analyst Becoming a successful BA
All About Business Analyst Becoming a successful BAZaranTech LLC

Resume_Sushant_Tyag_Updated
Resume_Sushant_Tyag_UpdatedResume_Sushant_Tyag_Updated
Resume_Sushant_Tyag_UpdatedSushant Tyagi

SDLC Process_Document.pptx
SDLC Process_Document.pptxSDLC Process_Document.pptx
SDLC Process_Document.pptxSivakumar Pola

Cisco Systems Case Study: The Architecture Review Process Improving the IT P...
Cisco Systems Case Study: The Architecture Review  Process Improving the IT P...Cisco Systems Case Study: The Architecture Review  Process Improving the IT P...
Cisco Systems Case Study: The Architecture Review Process Improving the IT P...Susan Bouchard

SixSigma 【Continuous Study】
SixSigma 【Continuous Study】SixSigma 【Continuous Study】
SixSigma 【Continuous Study】Jerimi Soma

The project manager and business analyst partnership - ensuring project success
The project manager and business analyst partnership - ensuring project successThe project manager and business analyst partnership - ensuring project success
The project manager and business analyst partnership - ensuring project successMark Troncone MBA, PMP, CBAP, ITILv3, CSM

IT Governance - COBIT 5 Capability Assessment
IT Governance - COBIT 5 Capability AssessmentIT Governance - COBIT 5 Capability Assessment
IT Governance - COBIT 5 Capability AssessmentEryk Budi Pratama

IFS Metrix Service Management: An Overview
IFS Metrix Service Management: An OverviewIFS Metrix Service Management: An Overview
IFS Metrix Service Management: An OverviewIFS

CIO Day and OPEX Banking & Finance Day
CIO Day and OPEX Banking & Finance DayCIO Day and OPEX Banking & Finance Day
CIO Day and OPEX Banking & Finance DayArtie Debidien

Course 1 Requirements Definition Overview.pptx
Course 1 Requirements Definition Overview.pptxCourse 1 Requirements Definition Overview.pptx
Course 1 Requirements Definition Overview.pptxadikesavulu

Similar to IT NPI Process (20)

Good IT Project Management
Good IT Project Management Good IT Project Management
Good IT Project Management

Debalina_Datta_Resume
Debalina_Datta_ResumeDebalina_Datta_Resume
Debalina_Datta_Resume

Training on ASAP Methodology.ppt
Training on ASAP Methodology.pptTraining on ASAP Methodology.ppt
Training on ASAP Methodology.ppt

Training on ASAP Methodology_11.10.2020.ppt
Training on ASAP Methodology_11.10.2020.pptTraining on ASAP Methodology_11.10.2020.ppt
Training on ASAP Methodology_11.10.2020.ppt

2014 sdlc project and gate process rollout published v6
2014 sdlc project and gate process rollout   published v62014 sdlc project and gate process rollout   published v6
2014 sdlc project and gate process rollout published v6

eCIO PPT Roles for a SAP and Systems Integration Project
eCIO PPT Roles for a SAP and Systems Integration ProjecteCIO PPT Roles for a SAP and Systems Integration Project
eCIO PPT Roles for a SAP and Systems Integration Project

SAP sample
SAP sampleSAP sample
SAP sample

Discovering New Product Introduction using Autodesk PLM 360 – Rodney Coffey, ...
Discovering New Product Introduction using Autodesk PLM 360 – Rodney Coffey, ...Discovering New Product Introduction using Autodesk PLM 360 – Rodney Coffey, ...
Discovering New Product Introduction using Autodesk PLM 360 – Rodney Coffey, ...

Discovering New Product Introduction (NPI) using Autodesk Fusion Lifecycle
Discovering New Product Introduction (NPI) using Autodesk Fusion LifecycleDiscovering New Product Introduction (NPI) using Autodesk Fusion Lifecycle
Discovering New Product Introduction (NPI) using Autodesk Fusion Lifecycle

All About Business Analyst Becoming a successful BA
All About Business Analyst Becoming a successful BAAll About Business Analyst Becoming a successful BA
All About Business Analyst Becoming a successful BA

Resume_Sushant_Tyag_Updated
Resume_Sushant_Tyag_UpdatedResume_Sushant_Tyag_Updated
Resume_Sushant_Tyag_Updated

SDLC Process_Document.pptx
SDLC Process_Document.pptxSDLC Process_Document.pptx
SDLC Process_Document.pptx

Cisco Systems Case Study: The Architecture Review Process Improving the IT P...
Cisco Systems Case Study: The Architecture Review  Process Improving the IT P...Cisco Systems Case Study: The Architecture Review  Process Improving the IT P...
Cisco Systems Case Study: The Architecture Review Process Improving the IT P...

SixSigma 【Continuous Study】
SixSigma 【Continuous Study】SixSigma 【Continuous Study】
SixSigma 【Continuous Study】

PAC Fast Track Implementation Program
PAC Fast Track Implementation ProgramPAC Fast Track Implementation Program
PAC Fast Track Implementation Program

The project manager and business analyst partnership - ensuring project success
The project manager and business analyst partnership - ensuring project successThe project manager and business analyst partnership - ensuring project success
The project manager and business analyst partnership - ensuring project success

IT Governance - COBIT 5 Capability Assessment
IT Governance - COBIT 5 Capability AssessmentIT Governance - COBIT 5 Capability Assessment
IT Governance - COBIT 5 Capability Assessment

IFS Metrix Service Management: An Overview
IFS Metrix Service Management: An OverviewIFS Metrix Service Management: An Overview
IFS Metrix Service Management: An Overview

CIO Day and OPEX Banking & Finance Day
CIO Day and OPEX Banking & Finance DayCIO Day and OPEX Banking & Finance Day
CIO Day and OPEX Banking & Finance Day

Course 1 Requirements Definition Overview.pptx
Course 1 Requirements Definition Overview.pptxCourse 1 Requirements Definition Overview.pptx
Course 1 Requirements Definition Overview.pptx

More from William Francis

More from William Francis (20)

Avinger SFDC Trunk Stock Discovery
Avinger SFDC Trunk Stock Discovery Avinger SFDC Trunk Stock Discovery
Avinger SFDC Trunk Stock Discovery

ADP Payroll Project
ADP Payroll Project  ADP Payroll Project
ADP Payroll Project

Infoblox Finance Cash Management
Infoblox Finance Cash Management Infoblox Finance Cash Management
Infoblox Finance Cash Management

Rovi bit dashboard
Rovi bit dashboard Rovi bit dashboard
Rovi bit dashboard

Rovi Business Solutions
Rovi Business Solutions Rovi Business Solutions
Rovi Business Solutions

Good Informatica IaaS
Good Informatica IaaS Good Informatica IaaS
Good Informatica IaaS

Good QTC OFI
Good QTC OFIGood QTC OFI
Good QTC OFI

Finance QBR
Finance QBRFinance QBR
Finance QBR

IPO Readiness SOX Sod
IPO Readiness SOX SodIPO Readiness SOX Sod
IPO Readiness SOX Sod

Overview of BOM and Inventory
Overview of BOM and InventoryOverview of BOM and Inventory
Overview of BOM and Inventory

VCP Workshop
VCP WorkshopVCP Workshop
VCP Workshop

VCP Roadmap
VCP RoadmapVCP Roadmap
VCP Roadmap

SCM Project Objectives
SCM Project ObjectivesSCM Project Objectives
SCM Project Objectives

Demand Planning process
Demand Planning processDemand Planning process
Demand Planning process

Rovi SFDC Community
Rovi SFDC CommunityRovi SFDC Community
Rovi SFDC Community

Rovi Apttus CPQ
Rovi Apttus CPQ Rovi Apttus CPQ
Rovi Apttus CPQ

Warehouse Management Overview
Warehouse Management OverviewWarehouse Management Overview
Warehouse Management Overview

IT Process Improvement
IT Process Improvement IT Process Improvement
IT Process Improvement

Common problems in business intelligence
Common problems in business intelligenceCommon problems in business intelligence
Common problems in business intelligence

Enterprise Architecture Verification Validation
Enterprise Architecture Verification Validation Enterprise Architecture Verification Validation
Enterprise Architecture Verification Validation

IT NPI Process

  • 1. New Product Introduction Process August 16, 2016
  • 2. 2 • Objective – Communicate and deploy the IT&BS NPI process • Agenda – Kick Off/Introduction (What, Why, Who & How) – Problem and Value Statement – Process Requirements – Critical Success Factors – Framework and Process Phases – Project Roles and Responsibilities – Documentation – Change Control – Q&A
  • 3. IT NPI: What, Why, Who & How What it is: A structured process for delivering IT solutions Why is it required: To deliver predictable high quality results on time and on budget, resulting in high customer satisfaction. Who’s involved: Both Business and IT (includes external Customer, Partners and Suppliers where applicable) How does it work It is an eight Phase Process with defined phase gates and both “Entry” and “Exit” criteria with clear boundaries of ownership.
  • 4. 4 IT NPI: Problem/Value Statement Problem Statement: – Projects are implemented at a very rapid pace with increasing demand for new capabilities. However: • Business requirements are light and change requests keep flowing up to go live. • Gaps in the IT solution delivered are realized post deployment, resulting in significant sustaining effort to stabilize the solution. • Cost of rework and ongoing support is very high. – This approach negatively impacts customer satisfaction, resulting in low morale and poor IT image Value Statement: – Establishing and adopting the IT NPI process will greatly improve the consistency, quality and reliability of new projects. A collaborative approach will help in delivering optimal products and services with: • Greater clarity of ownership of key deliverables at each phase. • Aligned business and IT expectations early in the implementation process. • Corrective action taken upfront verses at the end.
  • 5. 5 IT NPI: Process Requirements • Define a ‘lightweight’framework • Identify project management & governance requirements • Identify the key phases • Establish ownership for each phase • Define clear entry and exit criteria • Establish templates for each phase of the process • Establish communication framework
  • 6. 6 IT NPI: Critical Success Factors • Executive management commitment and support for adopting and using an NPI process – it is a cultural shift. • Commitment to process training to facilitate adoption. • Commitment to holding teams accountable for using the NPI process. • Commitment to continuous process inspection and improvement.
  • 7. IT NPI Process Metrics NPI Process Metrics Metric Definition/Calculation Area addressed Data Source Owner Project delivery timeliness # of schedule resets, driven by IT, for the project IT Project scoping and planning Manual Project Mgr Financial $ actually spent vs. $ budgeted Project budget estimation and management Manual Project Mgr # of tickets in tracking system # tickets logged post IT certification; during UAT Test coverage completeness up to IT certification Track It Dev Team Total ticket volume # tickets submitted each week after release Quality of solution and user training Track It Support Team # of PA tickets post release # of PA tickets daily for 1 month after release. Goal is zero. Solution readiness for deployment Track It Project Mgr # of Enhancement requests # of Enhancement tickets submitted at project close & weekly for 1 month after release. Quality of business requirements gathering and documentation Track It Support Team NPI Process adherence % of “mandatory” documents completed Use of NPI process Manual Project Mgr # Escalations (by business, vendors) # of escalations to CIO or above during the project IT/Business and Vendor/IT interlock strength and effectiveness of project communication Manual Project Mgr
  • 8. Review Request Assign to Bus App Queue Assess Request (Review with Submitter) Review/Prioritize Requests For Maintenance Release IT TICKET SUBMITTED BY BUSINESS/IT USER Close Helpdesk Ticket with resolution Major Enhancement L3 ? Review/Assess Request IT BSA /IT Manager Immediate action required ? Review/Prioritize Requests IT MGR-BSA & Business SME Follow IT-NPI Process For L3 Enhancements Assess Project Request (8 Step Process, Preliminary BRD & ROI) Review/Prioritize Projects Semi-Annual IT Steering Committee IT Steering Committee Approved ? Follow IT-NPI Process For Major Projects (L1, L2 Requests) Maintenance Release Quarterly Release Failure Or Minor Enhancement ? Assess Request Schedule for Implementation Schedule for implementation Monthly Release IT&BusinessServicesSupportTeamIT&BusinessServices L3 Enhancement ? Review/Assess Request IT Manager/DIR & Business SME/Director Review Request Assign to Bus App Support SME Follow IT-NPI Process For Failures & Minor Enhancements (L0 Incidents) L3 ENHANCEMENTS (< 2 Months) L0 FAILURES & MINOR ENHANCEMENTS (<80 Hours) L1/L2 PROJECTS Change Management Process
  • 9. IT New Product Introduction Process (IT-NPI) Phase Step Input Process Output (Deliverables) L0 L1 L2 L3 Investigate & Plan (Preliminary Stage) (EXPENSE) 1 Service Request Discovery  4 Square,  Project Plan, Cost Sheet & ROI  Project Kick-Off (Charter)  Preliminary BRD (Inventory of ASK) O X X O 2 Preliminary BRD Analyze  Detailed BRD  Support, Risk/Compliance requirements  SQA, DR & Security requirements  Production support requirements O X X O Execute Control & Track (Implementation Stage) (CAPITAL) 3 Detailed BRD Design  Functional Specifications  Business use cases  Sox Controls and DR Assessment  Testing and Production Support Plans O X X X 4 Functional Specifications Develop  Unit Tested System  Unit Test Cases  SOX, DR  Production Support Updates X X X X 5A Unit Tested IT Certification  IT Certification results  QA, SOX and DR test results O X X X 5B IT Certification Business UAT  Business Acceptance (GO/NO-GO) E-Mail  QA and DR Certified System  Systems Documentation  Train the Trainer (Expense task)  Cutover Plan, Application Delivery Signoff  IT Customer Support Plan O X X X 6 Cutover Plan Deployment  Production Support Documentation  Post Production Smoke Test  User Training (Expense task),  Production Support Transition/Knowledge Transfer X X X X Close & Sustain (Post Implementation) (EXPENSE) 7 Production Solution Support & Sustain  Production Solution  User Training  Joint Application Support X X X X 8 EOL Assessment End Of Live EOL Schedule O O X = Mandatory O = Optional
  • 10. IT NPI: 1- Discovery Phase 10 5-Test3-Design1-Discovery 4-Develop2-Analysis 6-Deploy 7-Support & Sustain Entry Criteria: - Key Inputs Discovery Phase: Owner: Business SME Assessment of business requirements for financial and technical viability. Exit Criteria: - Key Deliverables 1.IT Steering Committee Approval 2.8 Step Process complete 1.Assign Business & IT Project Champions (Project Mgrs.) 2.Develop 4-Square Chart 3.Define preliminary business requirements (BRD)/SOW 4.Define high level schedule, resources and budget 5.Develop preliminary project plan, project cost sheet & ROI 6.Build project ‘launch deck’ (ppt) 7.Identify core business use cases 1. Project 4-Square Chart 2. Preliminary BRD/SOW 3. Preliminary project plan, ROI & budget, scope, resource plan 4. Project ‘launch deck’
  • 11. IT NPI: 2 - Analysis Phase 11 5-Test3-Design 4-Develop1-Discovery 6-Deploy 7-Support & Sustain Entry Criteria: - Key Inputs Analysis Phase: Owner: IT-BSA Detailed feature set is defined based on completed business reqts. A detailed project plan, ROI, resources, and schedule is developed. Exit Criteria: - Key Deliverables 1. Project 4-Square Chart 2. Preliminary BRD/SOW 3. Preliminary Project Plan, ROI & Budget, Scope, Resource Plan 4. Project launch deck 1. Gain agreement on project charter (resource commit) 2. Conduct project kickoff meeting 3. Conduct requirements gathering workshops 4. Finalize requirements document 5. Initial infrastructure impact assessment, including all environments 6. Build /Buy and AS-IS/TO-BE analyses 1. Final Project Plan, ROI, Budget, Charter 2. Signed off Detailed BRD 3. Preliminary functional design and AS-IS/TO-BE process flows 4. Initial infrastructure assessment 5. Build vs. Buy decision 2-Analysis
  • 12. IT NPI: 3 - Design Phase 12 5-Test2-Analysis 4-Develop1-Discovery 6-Deploy 7-Support & Sustain 3-Design Entry Criteria: - Key Inputs Design Phase: Owner: IT-BSA Complete solution design with clearly documented specifications and schematics. Prototyping, POC occurs to confirm design meets requirements. Exit Criteria: - Key Deliverables 1. Final, detailed project plan, ROI, budget 2. Signed off BRD 3. Preliminary functional design and AS-IS/TO-BE process flows complete 4. Initial infrastructure assessment 5. Build vs. Buy decision 1.New business process documentation and review 2.Use case/testing strategy 3.Fit/Gap analysis 4.Functional and technical spec documentation 5.Functional and technical design reviews 6.Dev environment set up 7.SOX controls impact assessment 8.IT architecture review 1.Functional & Technical Design Specifications 2.Design review and sign off by business 3.IT architectural approval 4.SOX controls approval 5.Testing plans/business use cases 6.Infrastructure plan
  • 13. Entry Criteria: - Key Inputs Development Phase – Owner: IT Technical Analyst Solution coding, design reviews, and unit testing occurs. System, integration, regression, UAT test plans developed. Exit Criteria: - Key Deliverables 1. Functional & technical design specifications 2. Design review and sign off by business 3. IT architectural review, approval 4. SOX controls review, approval 5. Testing strategy/business use cases 6. Infrastructure plan 1.Code reviews 2.Code merges and builds 3.Solution configuration 4.Conduct unit testing 5.Develop system, integration, regression, UAT test plans, production cutover plans 6.Set up test and training environments 7.Develop user training plans and documentation 8.Develop release notes 1.Code unit tested 2.Test and production cutover plans 3.Test environment certification 4.User training plans 5.Release notes IT NPI: 4 - Development Phase 13 5-Test2-Analysis 3-Design1-Discovery 6-Deploy 7-Support & Sustain 4-Develop
  • 14. 14 Entry Criteria - Key inputs Test Phase – Full system and functionality is tested. Final production environment defined and detailed cutover plan developed. Exit Criteria - Key deliverables 1. Code unit tested 2. Test and production cutover plans 3. Test environment certification 4. User training plans 5. Release notes IT QA – Owner: IT BSA 1. Conduct system, integration, regression tests and production cutover simulation 2. Define final production environment 3. Define support plan, training, and resources 4. Issue tracking, fixes, re-testing 1. IT test sign off 2. Detailed cutover to production plan 3. All critical issues resolved 4. Release notes final 1. Approved UAT plan 2. Approved user training plan Bus UAT – Owner: Business SME 1. Refine business process flows 2. Conduct user training/conference room demo 3. Conduct UAT sessions 4. Issue tracking, fixes, re-testing 1. Business UAT sign off 2. Business process documentation final 3. All critical issues resolved IT NPI: 5 - Test Phase 4-Develop2-Analysis 3-Design1-Discovery 6-Deploy 7-Support & Sustain 5-Test
  • 15. Entry Criteria: - Key inputs Deployment Phase – Owner: IT PM Manage move to production environment. End to end testing to insure stability. Support processes are used. Exit Criteria: - Key deliverables 1. IT test sign off 2. Business UAT signoff 3. All critical issues resolved 4. Detailed cutover to production plan 5. Business process documentation final 6. Release notes final 1. Set up production environment and cutover to production 2. Stabilize solution 3. Conduct post go live smoke test 4. Organize support team, conduct training, and finalize support documentation 5. Conduct additional end user training, as needed 6. Finalize go live communication 1. Send go live communication 2. Production Smoke Test 3. All training complete 4. Capture deployment incidents 5. Support team ready IT NPI: 6 - Deployment Phase 15 5-Test2-Analysis 3-Design1-Discovery 4-Develop 6-Deploy 7-Support & Sustain
  • 16. Entry Criteria - Key inputs Support Phase – Owner: IT PM Support organization and processes have primary responsibility. Solution is under production change control and CCB. Exit Criteria - Key deliverables 1. Send go live communication 2. Production smoke test 3. All training complete 4. Capture deployment incidents 5. Support team ready 1. Conduct lessons learned session 2. Manage help desk tickets 3. Publish operations metrics 4. Fully deploy automated system monitoring 5. Conduct daily post go live status reviews 1. Production processes in full use 2. Service Level Agreements (SLAs) monitored 3. Code and environment maintained under change control 4. Lessons learned feedback action plan IT NPI: 7 - Support Phase 5-Test2-Analysis 3-Design1-Discovery 4-Develop 6-Deploy 7-Support & 8-Sustain
  • 17. Team Roles and Responsibilities • Estimate time required from project resources and get commitment from management • Have clearly defined roles and responsibilities for team members – efficient decision making – no gaps in project delivery • Involve business stakeholders up front, at Discovery Phase • provide clarity and thoroughness of business requirements • IT BSA and IT Management Sponsor must be involved up front, at Discovery Phase • work closely with the business to understand the problem/opportunity and provide clear functional requirements for the design phase
  • 18. 18 Project Team Level Description % Commitment Executive Senior management project sponsors who have the authority to approve and fund the project and commit resources. <5% Management Senior to mid-level managers responsible for a business area, technical aspect or post production support operations being impacted by the project. 5 - 10% Core Team Key IT and Business project leads responsible for planning, designing, executing and delivering the project to meet the business needs. Core team consists of Project Manager, Business Lead, Systems Lead, at a minimum. Additionally, it consists of functional resources. >25% Extended Team Extend team are those members who have a specific, smaller role in the project or who are acting as advisors or subject matter experts (SME) for the project. Examples include: Training Lead, SOX Compliance Specialist, Business Process Specialist. <5% Project Team Levels and Time Commitments
  • 19. Management and Lead Roles Executive Team Business Executive Sponsors Ultimate authority over project funding, scope, schedule and resource commitments. Responsible for scope and schedule changes. Technology Executive Sponsor Authority over project direction, technical architecture and system solution. Executive Stakeholder Executive level stakeholders with vested interest in the outcome of the project and who have significant influence or decision making power over the project. Management Team Business Process Owner Decision-maker over business processes, policies and business process changes resulting from the project implementation. Signs off on phases. Systems Owners Approvers of technical system architecture/development solution. Sign off on phases. Core Team Leads Business Champion (Project Manager) Primary business representative responsible for business requirements, processes, communications, deployment and benefits/impacts of the project. IT Champion (Project Manager) Ultimate owner of the project success. Manages scope, schedule and costs. Solution Architect Ultimate owner of the end system to meet business needs. Business Systems Analyst (BSA) Owner of business requirements analysis. Responsible for developing test scripts based on the business use cases, and conducting rigorous QA testing prior to business UAT.
  • 20. Core and Extended Team Core Team Business Functional Lead Owner of business use cases, business requirements , business process definitions, business training, business user testing, data quality, and end user documentation specific to their business or functional area. Infrastructure Lead Owner of defining infrastructure impact, requirements, and plans. Responsible for ensuring infrastructure is ready. DBA Owner of database planning and implementation. Technical Lead Owner of technical solution design, build, unit test and support through testing and deployment. Compliance and Standards Owner(s) Architectural Owner, Security and Risk Mgmt. Owner, Internal Audit Owner, Legal, Tax, and SOX Owners, Purchasing Owner Specialized team members who are critical to providing guidance, signoff and ownership of ensuring business and technology compliance and standards for the project. Extended Team Subject Matter Experts, Testers, Sys Admins, Developers, Release Engineers, Regional Reps. Team members who provide specific knowledge or support to the project team and have specific tasks, deliverables or reviewer responsibilities.
  • 21. NPI Process Documentation • Use the phase process templates to capture and communicate project information – Clarity of information across a multi-functional team – ‘1 source of information’ – Gets people on ‘the same page’ – Facilitates phase sign offs and commitment – Strengthens Business/IT interlock • Documents are currently stored on the network drive – Each project should set up folders on the share drive to store project documents and project correspondence – Templates and/or examples are provided for each phase NPI Process (link to all NPI Process material)
  • 22. Discovery Phase Documentation 4 Square Executive level project summary; including: - problem statement, - value proposition, - scope, costs, schedule, - dependencies, risks, assumptions - business and IT sponsors. Business Lead 8 Step Summary of key project milestones Business Lead Project Charter Document that formally authorizes project kickoff; including: - project objectives, assumptions, success factors, - scope, deliverables, schedule, costs, - project structure, team members and roles, - high level solution overview and approach, - communication plan, risk mgmt. plan, change mgmt. plan IT Project Mgr Preliminary Business Requirements (BRD) Initial capture of the business problem, business objectives and functional requirements from the business. Business Lead Budget/ROI Budget is a detailed and comprehensive accounting of project costs (capital and expense), including: - hardware, software, - resources (both internal and external) - operational costs. ROI is an analysis of the time it will take to recover the investment (budget), based on expected benefits. Business Lead
  • 23. Analysis Phase Documentation BRD (Completed) Defines business problem or opportunity, business objectives, business rules, and business requirements/use scenarios. The BRD also includes business situation background and organizational impact. Business Lead Project Plan Microsoft Project Plan with detailed deliverables, owners, and schedule Project Mgr Project Charter (kickoff deck) Use latest version of Charter ppt to conduct formal project launch meeting with project team members Project Mgr Team Roles and Responsibilities Documentation of each team member, their roles and responsibilities for the project Project Mgr RACIS Matrix Project responsibility split between the Business and IT Bus/IT Project Mgr Build vs. Buy Template Detailed analysis of pros and cons of build vs. buy option Project Mgr AS-IS/TO-BE Processes Visio diagrams and/or process steps and roles for each function to be performed of the current processes) and the proposed processes); highlighting the changes. Business Lead Preliminary Design Document Conceptual representation of the solution and how it will work Technical Lead
  • 24. Design and Develop Phases Documentation Functional Design Specifications Documentation of the details of how the solution will function, including requirements at a granular level, data field mapping, pick list values, concurrent request parameters. BSA Infrastructure Plan Documentation of how, where, when, and who, for the build out of the development, testing, staging, production environments. Shows where the systems are located w/r/t firewalls and other existing infrastructure. Also, documents how systems will be maintained, with owners. Infrastructure Lead Technical Design Specifications Final design document specifying how the solution is going to be designed. Technical Lead Test Plan Explains how unit testing, integration testing, regression testing, and all systems testing will be performed. Includes detailed procedures, test scripts, owners, and daily schedule of testing. Project Manager UAT Plan Plan which has several specific business use cases or scenarios which represent how the business users will actually use the solution. For each of these use cases, process steps are detailed, from the user perspective, and the users who will conduct the testing are identified. UAT will test the usability and suitability of the application in meeting the business needs. Business Lead/BSA Training Plan Outlines the detailed training plan including, the objectives and descriptions of the training sessions with; 1. Who will be trained; 2.Who the trainers will be; 3. Where, when and how training will occur; 4. What environment and staged data will be used for training. Business Lead
  • 25. Test and Deploy Phases Documentation Production Cutover Plan Detailed step by step, hour by hour, plan for the cutover from staging to production environment. Details what is to be done, who will do it, when it will be done. Project Manager Smoke Test Plan Detailed step by step plan for how production systems, data, and processes will be verified after cutover to production. Escalation contacts should be included. Project Manager Issue Tracking Log Captures all issues encountered during testing, level of severity, owner, mitigation plan. Log is maintained throughout testing and reviewed daily. Project Manager End User Training End user training and processes are provided to users so that they can fulfill their responsibilities using the new system/process Project Manager Business Readiness Phase sign off by business users, committing that they are ready for the deployment to production. Project Manager
  • 26. Support Phase Documentation Post Deployment Support For the first month after the release to production, IT conducts daily checkpoint meetings with business to monitor the application performance and track/resolve issues. Enhancement requests are captured for consideration in the future releases. Project Mgr Lesson Learned Documentation of the project outcomes of what worked and what didn't work. Includes improvement recommendations. Ultimately, this document is converted to an action plan with owners and timeframes. Project Mgr Change Control Request process and form This process captures change requests from the business after the project has already begun. These requests are reviewed and assessed for inclusion in the current release or a subsequent release. After the Design Phase, all change requests require the signature of an executive. Support Mgr
  • 27. 27Change Control: Executive Sponsor approval is required for changes after functional design is complete Change Request Instructions 1. Provide a succinct explanation to justify this change request. 2. The Change Request must be assessed for scope, schedule and budget impact both to this project and to other L1 and or L2 Products in the IT queue. 3. The project team must make best efforts to accommodate the change request within the published project parameters (Scope, Schedule, and Budget) where possible. 4. Changes having either schedule or budget impact must be approved by both the business and IT project sponsors. 5. If there are external impacts to other projects, approvals must be obtained from the respective business & IT project sponsors and project managers. 6. Approved changes will be prioritized for implementation and tracked as part of the overall project deliverables. 7. The Change Request number is a running sequence number reflecting the number of changes submitted for this project to date.
  • 28. 28 © 2006 RIVERBED TECHNOLOGY, INC – CONFIDENTIAL Page : 28 Change Request Form Ref Nbr: 001 Project: HRIS – SS Implementation Date: 08/12/16 Description: Additional time is required to re-engineer and gather requirements for providing Absence Management, including accrual tracking, within the Self Service functions. Business Benefits: Provide global absence tracking, accruals and reporting from single source system. Impact if not implemented:  No centralized tracking of employee absences. Alternatives:  None Project Impact: 1.Schedule: No Change to Go Live date. 2.Budget: $25,000 increase for T&M. 3.Cross Functional impact: N Approvals: 1.Project Steering Committee: Date: 08/15/16 2.Project Sponsor : Date: 08/15/16 3.Cross Functional Business/IT PMs :Date: 08/15/16 Comments:
  • 29. Project: Oracle In-House (4-Square Sample) Problem to Solve: The ramp time to on-board new Oracle capabilities using the Oracle On-Demand (OOD) service is cumbersome and will impede plans to scale IT Application infrastructure to support future business growth. Value Proposition: • Reduce cycle time for on-boarding new modules. • Maintain primary control of core financial and manufacturing systems. • Reduce long terms IT infrastructure support costs Business Stake Holders: - Exec. Sponsor: nnnn. - Business Champion: Finance, Sales, Ops, Sales Ops & Support IT Partners: - IT Champion: nnnn - Application: nnnn - Infrastructure nnnn Dependencies: • Business resources to support UAT in Q216 • IT Infrastructure readiness • Restrict new Oracle project implementation in 1Q17 Risks: • Changes to OOD during transition period. • Availability of business QA resource in Q216 Assumptions: • Technical as-is migration from OOD to In-house IT Ops. • Business commitment to reduce new projects impacting OOD and business resource commitment to QA new service Scope: Migrate Oracle (AS-IS functionality) from OOD to RVBD in-house environment. Schedule: - 2H16: Discovery - 1H17: Implementation & rollout Cost: $ 900K (Estimate) Status: To be prioritized
