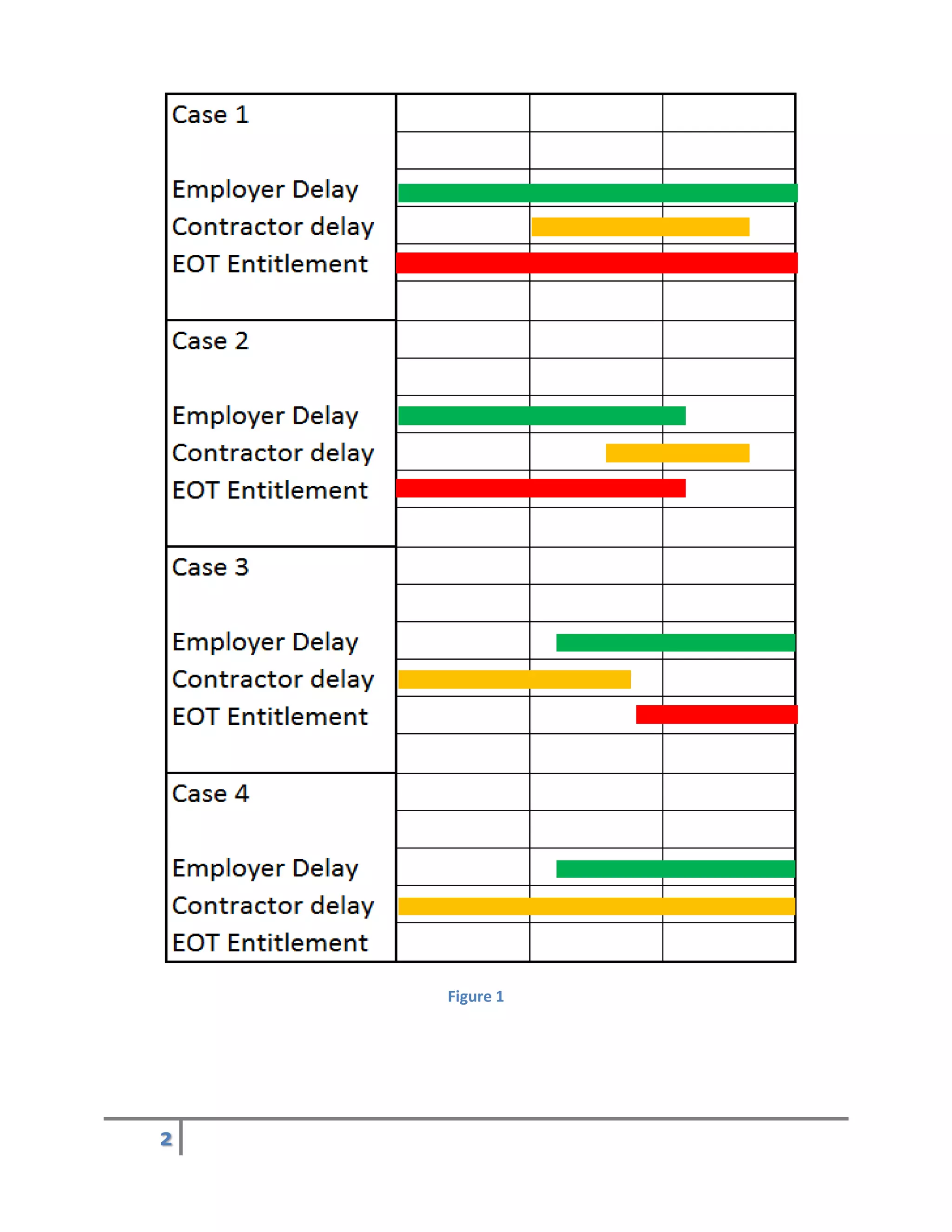

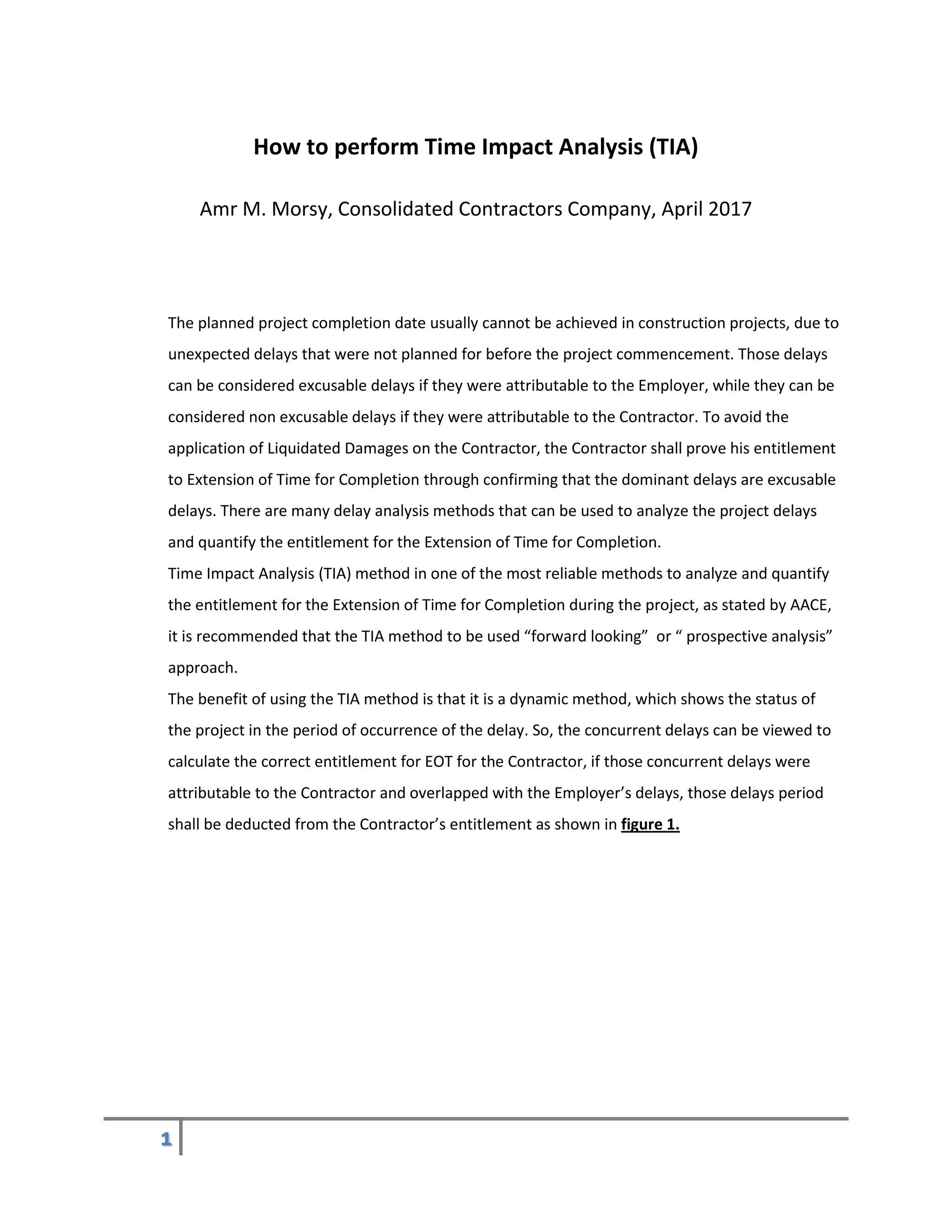

The document outlines the process of performing Time Impact Analysis (TIA) to assess delays in construction projects, differentiating between excusable and non-excusable delays. It emphasizes the need for a forensic planner to identify fragnets, select suitable updated programs, and analyze the impact of delays on project completion dynamically. The TIA method is recommended for use during the occurrence of delays to determine entitlement for extensions of time for completion effectively.
