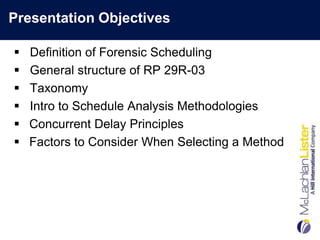

Presentation Objectives

   Definition of Forensic Scheduling
   General structure of RP 29R-03
   Taxonomy
   Intro to Schedule Analysis Methodologies
   Concurrent Delay Principles

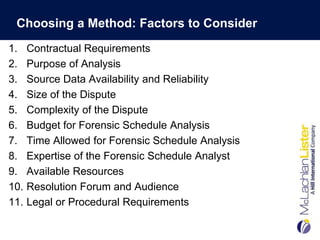

   Factors to Consider When Selecting a Method
A Good Indication….

That You Need a F.S. Expert….Soon!!!

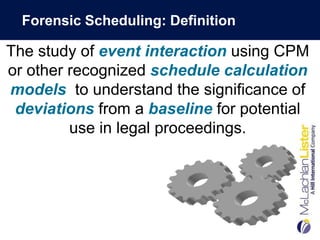

Forensic Scheduling: Definition

The study of event interaction using CPM
or other recognized schedule calculation
models to understand the significance of
 deviations from a baseline for potential
         use in legal proceedings.

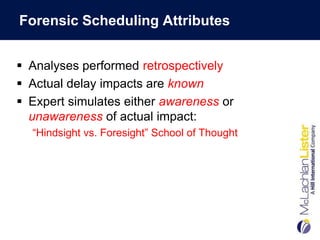

Forensic Scheduling Attributes

 Analyses performed retrospectively
 Actual delay impacts are known
 Expert simulates either awareness or
  unawareness of actual impact:
  “Hindsight vs. Foresight” School of Thought

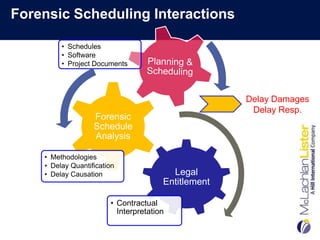

Forensic Scheduling Interactions

         • Schedules
         • Software
         • Project Documents

                                                     Delay Damages
                                                      Delay Resp.
                   Forensic
                   Schedule
                   Analysis

    • Methodologies
    • Delay Quantification
    • Delay Causation                    Legal
                                       Entitlement

                        • Contractual
                          Interpretation

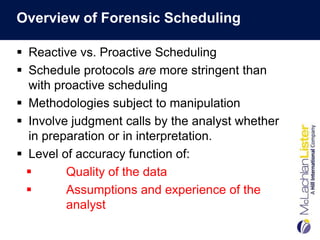

Overview of Forensic Scheduling

 Reactive vs. Proactive Scheduling
 Schedule protocols are more stringent than
  with proactive scheduling
 Methodologies subject to manipulation
 Involve judgment calls by the analyst whether
  in preparation or in interpretation.
 Level of accuracy function of:
        Quality of the data
        Assumptions and experience of the
         analyst

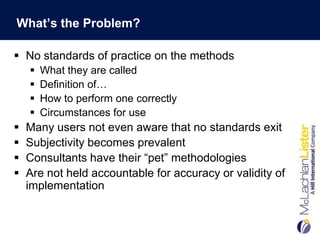

What’s the Problem?

 No standards of practice on the methods
       What they are called
       Definition of…
       How to perform one correctly
       Circumstances for use
   Many users not even aware that no standards exit
   Subjectivity becomes prevalent
   Consultants have their “pet” methodologies
   Are not held accountable for accuracy or validity of
    implementation
What is RP 29R-03?

 A free publication of AACEi
 Recommended Practice for
  performing forensic CPM
  schedule analyses
 Latest Revision-April 25,
  2011
 Becoming a known
  standard in the industry and
  in litigation
History of RP 29R-03

 RP 29R-03 Originated with AACEi in 2003
 Proposal that the Claims and Dispute Resolution
  (CDR) Committee write a RP on schedule delay
  analysis
 The purpose was to establish “reliable principles and
  methods.”
 Committee was formed on a volunteer basis
  – Open to anyone
  – 20 co-authors
  – More than 100 reviewers
 Official Release: June 25, 2007
The Purpose of 29R-03

 To provide a unifying technical reference for
  the forensic application of critical path
  method (CPM) scheduling analyses
 Goal is to:
   Minimize procedural subjectivity
   Increase transparency in forensic analyses
 To be an advisory document
 To be used in conjunction with professional
  judgment, experience, and knowledge of the
  subject matter.

Where is the RP Located?

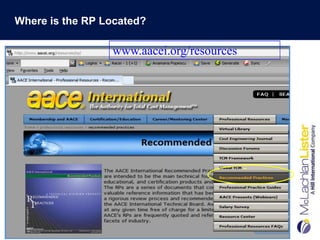

                 www.aacei.org/resources

                                       13
Where is the RP Located?
RP 29R-03 Structure
Part 1. Organization & Scope
   1.1. Introduction
   1.2 Basic Premise & Assumptions
   1.3 Scope & Focus
   1.4 Taxonomy & Nomenclature
   1.5 Underlying Fundamentals & General Principles
Part 2. Source Validation Protocols
Part 3. Method Implementation Protocols
Part 4. Analysis Interpretation Protocols
Part 5. Choosing a Method

Layer 1: Timing

                          Layer 2: Basic Methods

                         Layer 3: Specific Methods

                        Layer 4: Basic Implementation
    Layer 5: Fixed Periods vs. Variable              Layer 5: Global (Insertion/Extraction)
                Periods                               vs. Stepped (Insertion/ Extraction)

As-Planned                           Reconstructed                  Time
             Windows                                  Impacted               Collapsed As-Built
    Vs.                 Half-Step       Update                     Impact
             Analysis                                As-Planned              “But-for” Analysis
 As-Built                              Analysis                   Analysis
Observational Techniques

As-Planned vs. As-Built

   Comparison of start/finish dates between two schedule updates
   Purely mathematical-Variance between dates
As-Planned vs. As-Built
                       Delayed Completion

               1                    Early Start
                   2                                                   Overall Delay
                                       3
                                                       4
  As-Planned
  As-Built
               1                                       Delayed Start

                        2           Early Completion
                                            3
As-Planned vs. As-Built

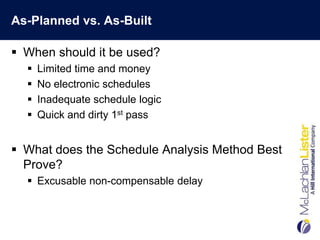

 When should it be used?
     Limited time and money
     No electronic schedules
     Inadequate schedule logic
     Quick and dirty 1st pass

 What does the Schedule Analysis Method Best
  Prove?
   Excusable non-compensable delay
As-Planned vs. As-Built

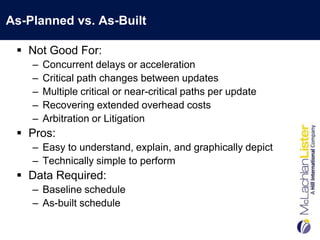

  Not Good For:
    –   Concurrent delays or acceleration
    –   Critical path changes between updates
    –   Multiple critical or near-critical paths per update
    –   Recovering extended overhead costs
    –   Arbitration or Litigation
  Pros:
    – Easy to understand, explain, and graphically depict
    – Technically simple to perform
  Data Required:
    – Baseline schedule
    – As-built schedule
Windows Analysis
 Definition
   –   Observational Forward-looking technique
   –   Quantify loss or gain of time along a float path
   –   Loss and gains tallied by window
   –   A “window” is the time period framed between two
       revisions:
        • The as-planned schedule for the beginning of the
          window
        • The as-built schedule for the end of the window

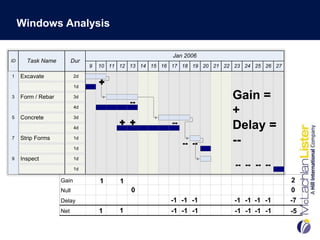

Windows Analysis

                                                         Jan 2006
ID     Task Name          Dur
                                9   10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27
1    Excavate              2d
                                    Ì
2                          1d

3    Form / Rebar          3d
                                              ¬¬
                                                                          Gain =
4

5    Concrete
                           4d

                           3d
                                                                          +
                                          Ì Ì            ¬¬
6                          4d                                             Delay =
7

8
     Strip Forms           1d

                           1d
                                                              ¬¬ ¬¬       --
9    Inspect               1d

10                         1d
                                                                           ¬¬ ¬¬ ¬¬ ¬¬

                    Gain            1     1                                                 2
                    Null                      0                                             0
                    Delay                                -1 -1 -1          -1 -1 -1 -1      -7
                    Net             1     1              -1 -1 -1          -1 -1 -1 -1      -5
Windows Analysis

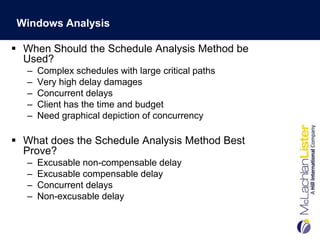

 When Should the Schedule Analysis Method be
  Used?
   –   Complex schedules with large critical paths
   –   Very high delay damages
   –   Concurrent delays
   –   Client has the time and budget
   –   Need graphical depiction of concurrency

 What does the Schedule Analysis Method Best
  Prove?
   –   Excusable non-compensable delay
   –   Excusable compensable delay
   –   Concurrent delays
   –   Non-excusable delay
Modeled Techniques
Impacted As-Planned

 Definition
   – Insertion of impact activities into a baseline or
     update schedule
   – Integrated into the network logic before, in-
     between, or after the activity it affected
   – Additive model that simulates the possible effect
     of actual delay events to the schedule completion
     date
   – Comparison of IAP schedule and succeeding
     update to determine possible acceleration or non-
     excusable delays
   – Comparison of IAP schedule and planned
     schedule to determine time extension

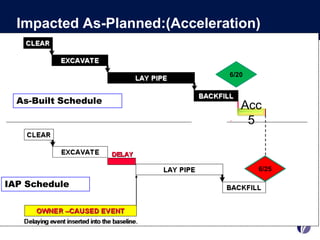

Impacted As-Planned:(Acceleration)

                               6/20

  As-Built Schedule
                                  Acc
                                   5

                                      6/25

IAP Schedule
Impacted As-Planned:(Time Extension Example)

                                        6/18

                                                  (2 Days)

                                               6/20

   IAP Schedule
Impacted As-Planned

 When Should the Schedule Analysis Method be
  Used?
  – Indemnification of liquidated damages
  – For preliminary negotiations between owner and
    contractor
 What does the Schedule Analysis Method Best
  Prove?
  – Requests for Time Extension or LD Waivers
  – Acceleration Claims
Collapsed As-Built

 Definition
   – Subtractive model that simulates the effect of
     extracting delays from the schedule on the completion
     date
   – Create a Simulated As-Built Schedule (actual float)
   – Find the As-Built Critical Path based on driving
     activities
   – Remove entire activities or decrease durations, lags
   – “But-for” this delay, I would have finished on x date

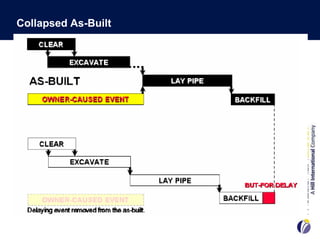

Collapsed As-Built
Collapsed As-Built

 When Should the Schedule Analysis Method be
  Used?
  – Need to prove concurrency of delays
  – Need to recover Extended Overhead Costs

 What does the Schedule Analysis Method Best
  Prove?
  – Concurrent delays
  – Excusable compensable delays
Concurrent Delay

                   ‘S
Concurrent Delay - Requirements

   Two or more delays during the “same” time
   There can only be one unit of delay during the same
    unit of time, regardless of the number of delaying
    events
   Delays unrelated and independent
   Must delay the critical path
   Responsibility of different parties
   Each party bears its own expenses for that delay
   Involuntary (i.e., not “pacing”)
   Substantial and not easily curable

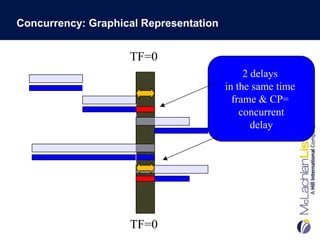

Concurrency: Graphical Representation

                    TF=0
                                             2 delays
                                        in the same time
                                          frame & CP=
                                            concurrent
                                               delay

                    TF=0

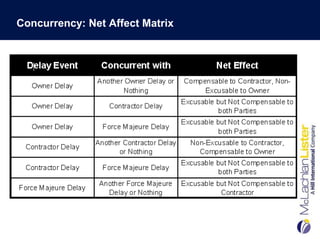

Concurrency: Net Affect Matrix
Critical Path: Longest Path vs. Negative Float
Theory
  The Negative Float Theory
     – criticality on any activity that has negative total float relative to a
       contractual milestone.
     – any delays, occasioned by negative total float, occurring during the
       same measurement period are potential candidates for concurrency.
  The Longest Path Theory
    – all paths shorter than the longest path (even those with
      negative total float) have positive total float with respect to the
      longest path and are therefore not critical
  Concurrency analyses should always be consistent
   with the contracts’ definition of criticality
Literal vs. Functional Concurrency

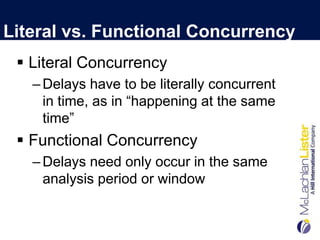

  Literal Concurrency
   – Delays have to be literally concurrent
     in time, as in “happening at the same
     time”
  Functional Concurrency
   – Delays need only occur in the same
     analysis period or window
Literal Concurrency

 Delays literally happening at the same time
 Both delays must be on the critical path
 First delay (chronologically) creates float for
  subsequent delays – even if only one day apart
 Far fewer findings of concurrency than
  functional theory

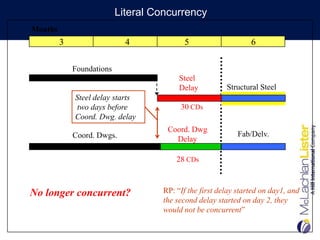

Literal Concurrency Example

Foundations               Structural Steel
                   4
                                                    Roof
                                               4

                                      Curtainwall 1
                                                                  Interior Finishes     Punch

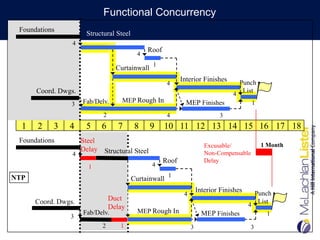

                                                            4
         Coord. Dwgs.                                                                 4
                                                                                         List
                         Fab/Delv.         MEP Rough In               MEP Finishes          1
                   3
Months                           2                          4                   3
 1       2    3    4      5      6     7      8     9      10 11 12 13 14 15 16 17 18
                       Steel
Foundations            Delay                                Literal Concurrency                 1 Month
                                 Structural Steel
                   4
                                                           Roof                 Excusable/
                          1                          4                          Non-Compensable
                                                                                Delay
                                             Curtainwall 1
                  Coord.
                   Dwg                                                  Interior Finishes     Punch
                                                                  4
     Coord. Dwgs. Delay                                                                     4
                                                                                               List
                                Fab/Delv.      MEP Rough In
                   3      1                                               MEP Finishes            1
                                       2                          4                   3
Literal Concurrency
Months
         3                   4           5               6

             Foundations
                                        Steel
                                        Delay     Structural Steel

                                        30 CDs

                                     Coord. Dwg
             Coord. Dwgs.                            Fab/Delv.
                                       Delay

                                       30 CDs
Literal Concurrency
Months
         3                   4            5                     6

             Foundations
                                         Steel
                                         Delay          Structural Steel
             Steel delay starts
             two days before             30 CDs
             Coord. Dwg. delay
                                     Coord. Dwg
             Coord. Dwgs.                                   Fab/Delv.
                                       Delay

                                        28 CDs

No longer concurrent?               RP: “If the first delay started on day1, and
                                    the second delay started on day 2, they
                                    would not be concurrent”
Functional Concurrency

   Delays occurring within the same analysis period or window
   Sequential delays within a period may be viewed as concurrent
   More liberal identification of concurrent delays than Literal theory
   If reduce analysis to single day periods, Functional may be same
    as Literal
Functional Concurrency
 Foundations
                          Structural Steel
                     4
                                                  Roof
                                              4

                                      Curtainwall 1
                                                                Interior Finishes       Punch
                                                          4
          Coord. Dwgs.                                                                4
                                                                                         List
                         Fab/Delv.      MEP Rough In              MEP Finishes                1
                     3
 Months                         2                         4                      3
  1       2    3    4     5    6       7      8    9     10 11 12 13 14 15 16 17 18
 Foundations           Steel
                                                                            Excusable/            1 Month
                       Delay Structural Steel
                     4                                                      Non-Compensable
                                                         Roof               Delay
                          1                        4

NTP                                          Curtainwall 1
                                                                         Interior Finishes     Punch
                                                                 4
          Coord. Dwgs.              Duct                                                        List
                                    Delay                                                    4
                         Fab/Delv.             MEP Rough In                MEP Finishes            1
                    3
                               2       1                             3                       3
Schedule Update Month 5
 Foundations
                           Structural Steel
                     4
                                                    Roof
                                                4

                                      Curtainwall 1
                                                                  Interior Finishes       Punch
                                                            4
      Coord. Dwgs.                                                                      4
                                                                                           List
                         Fab/Delv.      MEP Rough In                MEP Finishes                1
                  3
 Months                          2                          4                      3
  1       2   3   4       5      6     7       8     9     10 11 12 13 14 15 16 17 18
 Foundations             Steel
                         Delay                                                                      1 Month
                                  Structural Steel
                     4                                                                                   Excusable/
                                                           Roof                                          Compensable
                           1                         4
                                                                                                         Delay
NTP                                           Curtainwall 1
                                                                           Interior Finishes     Punch
                                                                   4
      Coord. Dwgs.                                                                             4
                                                                                                  List
                         Fab/Delv.              MEP Rough In                 MEP Finishes            1
                  3
                                 2                                     3                       3

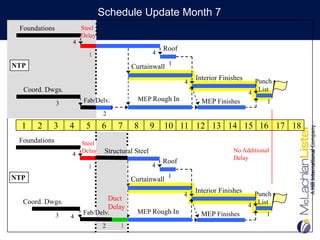

Schedule Update Month 7
 Foundations           Steel
                       Delay
                   4
                                                       Roof
                         1                         4

NTP                                        Curtainwall 1
                                                                  Interior Finishes     Punch
                                                              4
  Coord. Dwgs.                                                                        4
                                                                                         List
                       Fab/Delv.             MEP Rough In           MEP Finishes           1
               3
 Months                        2

  1       2   3    4    5      6      7     8      9   10 11 12 13 14 15 16 17 18
 Foundations           Steel
                       Delay    Structural Steel                               No Additional
                   4
                                                                               Delay
                                                       Roof
                         1                         4

NTP                                        Curtainwall 1
                                                                  Interior Finishes     Punch
                                                              4
  Coord. Dwgs.                     Duct                                                  List
                                   Delay                                              4
                       Fab/Delv.             MEP Rough In           MEP Finishes           1
               3   4
                               2      1
Pacing vs. Concurrency: What’s the Difference?
Pacing

  Pacing is a conscious choice by the
   performing party to proceed at a slower
   rate of work with the knowledge of the
   other contemporaneous delay

         Answers the Question:
         Why hurry up and wait?

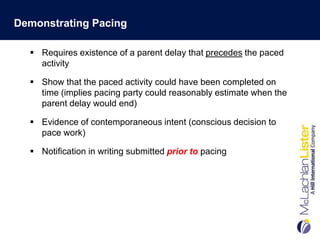

Demonstrating Pacing

   Requires existence of a parent delay that precedes the paced
    activity

   Show that the paced activity could have been completed on
    time (implies pacing party could reasonably estimate when the
    parent delay would end)

   Evidence of contemporaneous intent (conscious decision to
    pace work)

   Notification in writing submitted prior to pacing

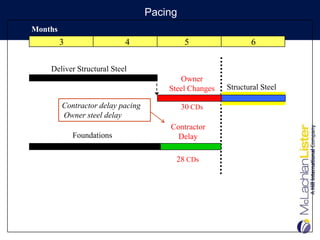

Pacing
Months
         3                 4                 5                6

    Deliver Structural Steel
                                          Owner
                                       Steel Changes   Structural Steel

         Contractor delay pacing            30 CDs
         Owner steel delay
                                       Contractor
             Foundations                 Delay

                                         28 CDs
Choosing a Method: Factors to Consider
1.    Contractual Requirements
2.    Purpose of Analysis
3.    Source Data Availability and Reliability
4.    Size of the Dispute
5.    Complexity of the Dispute
6.    Budget for Forensic Schedule Analysis
7.    Time Allowed for Forensic Schedule Analysis
8.    Expertise of the Forensic Schedule Analyst
9.    Available Resources
10.   Resolution Forum and Audience
11.   Legal or Procedural Requirements
Contact Information

                          Brisbane Office
                       2/19 Musgrave Street
                       West End, QLD, 4101
              Email: anamariap@mclachlanlister.com
                     Phone: 61 07 3255 0223

       Sydney Office                       Perth Office
  Level 1, 1 Hickson Road                189 Colin Place
  Phone: 61 02 9241 7328              Phone: 61 08 9480 0647

Forensic schedule analysis acesss

  • 1.
    Forensic Schedule AnalysisTechniques: Unveiling the Mystery Using the AACEi Recommended Practice 29R-03 Presented to: Dr. Anamaria Popescu, PE,PSP, PMP McLachlan Lister-Hill International Australia February 28, 2012
  • 2.
    Anamaria Popescu  Associate Director-McLL in Brisbane  Project Auditing Services  Project Controls Implementation  Construction Claims Expertise  Forensic Schedule Analysis  Joined Hill International in 2011  Consulting to the Oil and Gas Industry  University of Texas at Austin  Civil Engineering/CEPM Program  PhD in Schedule Analysis  PM at Enron
  • 3.
    Presentation Objectives  Definition of Forensic Scheduling  General structure of RP 29R-03  Taxonomy  Intro to Schedule Analysis Methodologies  Concurrent Delay Principles  Factors to Consider When Selecting a Method
  • 4.
    A Good Indication…. ThatYou Need a F.S. Expert….Soon!!!
  • 5.
    Forensic Scheduling: Definition Thestudy of event interaction using CPM or other recognized schedule calculation models to understand the significance of deviations from a baseline for potential use in legal proceedings.
  • 6.
    Forensic Scheduling Attributes Analyses performed retrospectively  Actual delay impacts are known  Expert simulates either awareness or unawareness of actual impact: “Hindsight vs. Foresight” School of Thought
  • 7.
    Forensic Scheduling Interactions • Schedules • Software • Project Documents Delay Damages Delay Resp. Forensic Schedule Analysis • Methodologies • Delay Quantification • Delay Causation Legal Entitlement • Contractual Interpretation
  • 8.
    Overview of ForensicScheduling  Reactive vs. Proactive Scheduling  Schedule protocols are more stringent than with proactive scheduling  Methodologies subject to manipulation  Involve judgment calls by the analyst whether in preparation or in interpretation.  Level of accuracy function of:  Quality of the data  Assumptions and experience of the analyst
  • 9.
    What’s the Problem? No standards of practice on the methods  What they are called  Definition of…  How to perform one correctly  Circumstances for use  Many users not even aware that no standards exit  Subjectivity becomes prevalent  Consultants have their “pet” methodologies  Are not held accountable for accuracy or validity of implementation
  • 10.
    What is RP29R-03?  A free publication of AACEi  Recommended Practice for performing forensic CPM schedule analyses  Latest Revision-April 25, 2011  Becoming a known standard in the industry and in litigation
  • 11.
    History of RP29R-03  RP 29R-03 Originated with AACEi in 2003  Proposal that the Claims and Dispute Resolution (CDR) Committee write a RP on schedule delay analysis  The purpose was to establish “reliable principles and methods.”  Committee was formed on a volunteer basis – Open to anyone – 20 co-authors – More than 100 reviewers  Official Release: June 25, 2007
  • 12.
    The Purpose of29R-03  To provide a unifying technical reference for the forensic application of critical path method (CPM) scheduling analyses  Goal is to:  Minimize procedural subjectivity  Increase transparency in forensic analyses  To be an advisory document  To be used in conjunction with professional judgment, experience, and knowledge of the subject matter.
  • 13.
    Where is theRP Located? www.aacei.org/resources 13
  • 14.
    Where is theRP Located?
  • 15.
    RP 29R-03 Structure Part1. Organization & Scope 1.1. Introduction 1.2 Basic Premise & Assumptions 1.3 Scope & Focus 1.4 Taxonomy & Nomenclature 1.5 Underlying Fundamentals & General Principles Part 2. Source Validation Protocols Part 3. Method Implementation Protocols Part 4. Analysis Interpretation Protocols Part 5. Choosing a Method
  • 16.
    Layer 1: Timing Layer 2: Basic Methods Layer 3: Specific Methods Layer 4: Basic Implementation Layer 5: Fixed Periods vs. Variable Layer 5: Global (Insertion/Extraction) Periods vs. Stepped (Insertion/ Extraction) As-Planned Reconstructed Time Windows Impacted Collapsed As-Built Vs. Half-Step Update Impact Analysis As-Planned “But-for” Analysis As-Built Analysis Analysis
  • 17.
  • 18.
    As-Planned vs. As-Built  Comparison of start/finish dates between two schedule updates  Purely mathematical-Variance between dates
  • 19.
    As-Planned vs. As-Built Delayed Completion 1 Early Start 2 Overall Delay 3 4 As-Planned As-Built 1 Delayed Start 2 Early Completion 3
  • 20.
    As-Planned vs. As-Built When should it be used?  Limited time and money  No electronic schedules  Inadequate schedule logic  Quick and dirty 1st pass  What does the Schedule Analysis Method Best Prove?  Excusable non-compensable delay
  • 21.
    As-Planned vs. As-Built  Not Good For: – Concurrent delays or acceleration – Critical path changes between updates – Multiple critical or near-critical paths per update – Recovering extended overhead costs – Arbitration or Litigation  Pros: – Easy to understand, explain, and graphically depict – Technically simple to perform  Data Required: – Baseline schedule – As-built schedule
  • 22.
    Windows Analysis  Definition – Observational Forward-looking technique – Quantify loss or gain of time along a float path – Loss and gains tallied by window – A “window” is the time period framed between two revisions: • The as-planned schedule for the beginning of the window • The as-built schedule for the end of the window
  • 23.
    Windows Analysis Jan 2006 ID Task Name Dur 9 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 1 Excavate 2d Ì 2 1d 3 Form / Rebar 3d ¬¬ Gain = 4 5 Concrete 4d 3d + Ì Ì ¬¬ 6 4d Delay = 7 8 Strip Forms 1d 1d ¬¬ ¬¬ -- 9 Inspect 1d 10 1d ¬¬ ¬¬ ¬¬ ¬¬ Gain 1 1 2 Null 0 0 Delay -1 -1 -1 -1 -1 -1 -1 -7 Net 1 1 -1 -1 -1 -1 -1 -1 -1 -5
  • 24.
    Windows Analysis  WhenShould the Schedule Analysis Method be Used? – Complex schedules with large critical paths – Very high delay damages – Concurrent delays – Client has the time and budget – Need graphical depiction of concurrency  What does the Schedule Analysis Method Best Prove? – Excusable non-compensable delay – Excusable compensable delay – Concurrent delays – Non-excusable delay
  • 25.
  • 26.
    Impacted As-Planned  Definition – Insertion of impact activities into a baseline or update schedule – Integrated into the network logic before, in- between, or after the activity it affected – Additive model that simulates the possible effect of actual delay events to the schedule completion date – Comparison of IAP schedule and succeeding update to determine possible acceleration or non- excusable delays – Comparison of IAP schedule and planned schedule to determine time extension
  • 27.
    Impacted As-Planned:(Acceleration) 6/20 As-Built Schedule Acc 5 6/25 IAP Schedule
  • 28.
    Impacted As-Planned:(Time ExtensionExample) 6/18 (2 Days) 6/20 IAP Schedule
  • 29.
    Impacted As-Planned  WhenShould the Schedule Analysis Method be Used? – Indemnification of liquidated damages – For preliminary negotiations between owner and contractor  What does the Schedule Analysis Method Best Prove? – Requests for Time Extension or LD Waivers – Acceleration Claims
  • 30.
    Collapsed As-Built  Definition – Subtractive model that simulates the effect of extracting delays from the schedule on the completion date – Create a Simulated As-Built Schedule (actual float) – Find the As-Built Critical Path based on driving activities – Remove entire activities or decrease durations, lags – “But-for” this delay, I would have finished on x date
  • 31.
  • 32.
    Collapsed As-Built  WhenShould the Schedule Analysis Method be Used? – Need to prove concurrency of delays – Need to recover Extended Overhead Costs  What does the Schedule Analysis Method Best Prove? – Concurrent delays – Excusable compensable delays
  • 33.
  • 34.
    Concurrent Delay -Requirements  Two or more delays during the “same” time  There can only be one unit of delay during the same unit of time, regardless of the number of delaying events  Delays unrelated and independent  Must delay the critical path  Responsibility of different parties  Each party bears its own expenses for that delay  Involuntary (i.e., not “pacing”)  Substantial and not easily curable
  • 35.
    Concurrency: Graphical Representation TF=0 2 delays in the same time frame & CP= concurrent delay TF=0
  • 36.
  • 37.
    Critical Path: LongestPath vs. Negative Float Theory  The Negative Float Theory – criticality on any activity that has negative total float relative to a contractual milestone. – any delays, occasioned by negative total float, occurring during the same measurement period are potential candidates for concurrency.  The Longest Path Theory – all paths shorter than the longest path (even those with negative total float) have positive total float with respect to the longest path and are therefore not critical  Concurrency analyses should always be consistent with the contracts’ definition of criticality
  • 38.
    Literal vs. FunctionalConcurrency  Literal Concurrency – Delays have to be literally concurrent in time, as in “happening at the same time”  Functional Concurrency – Delays need only occur in the same analysis period or window
  • 39.
    Literal Concurrency  Delaysliterally happening at the same time  Both delays must be on the critical path  First delay (chronologically) creates float for subsequent delays – even if only one day apart  Far fewer findings of concurrency than functional theory
  • 40.
    Literal Concurrency Example Foundations Structural Steel 4 Roof 4 Curtainwall 1 Interior Finishes Punch 4 Coord. Dwgs. 4 List Fab/Delv. MEP Rough In MEP Finishes 1 3 Months 2 4 3 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 Steel Foundations Delay Literal Concurrency 1 Month Structural Steel 4 Roof Excusable/ 1 4 Non-Compensable Delay Curtainwall 1 Coord. Dwg Interior Finishes Punch 4 Coord. Dwgs. Delay 4 List Fab/Delv. MEP Rough In 3 1 MEP Finishes 1 2 4 3
  • 41.
    Literal Concurrency Months 3 4 5 6 Foundations Steel Delay Structural Steel 30 CDs Coord. Dwg Coord. Dwgs. Fab/Delv. Delay 30 CDs
  • 42.
    Literal Concurrency Months 3 4 5 6 Foundations Steel Delay Structural Steel Steel delay starts two days before 30 CDs Coord. Dwg. delay Coord. Dwg Coord. Dwgs. Fab/Delv. Delay 28 CDs No longer concurrent? RP: “If the first delay started on day1, and the second delay started on day 2, they would not be concurrent”
  • 43.
    Functional Concurrency  Delays occurring within the same analysis period or window  Sequential delays within a period may be viewed as concurrent  More liberal identification of concurrent delays than Literal theory  If reduce analysis to single day periods, Functional may be same as Literal
  • 44.
    Functional Concurrency Foundations Structural Steel 4 Roof 4 Curtainwall 1 Interior Finishes Punch 4 Coord. Dwgs. 4 List Fab/Delv. MEP Rough In MEP Finishes 1 3 Months 2 4 3 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 Foundations Steel Excusable/ 1 Month Delay Structural Steel 4 Non-Compensable Roof Delay 1 4 NTP Curtainwall 1 Interior Finishes Punch 4 Coord. Dwgs. Duct List Delay 4 Fab/Delv. MEP Rough In MEP Finishes 1 3 2 1 3 3
  • 45.
    Schedule Update Month5 Foundations Structural Steel 4 Roof 4 Curtainwall 1 Interior Finishes Punch 4 Coord. Dwgs. 4 List Fab/Delv. MEP Rough In MEP Finishes 1 3 Months 2 4 3 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 Foundations Steel Delay 1 Month Structural Steel 4 Excusable/ Roof Compensable 1 4 Delay NTP Curtainwall 1 Interior Finishes Punch 4 Coord. Dwgs. 4 List Fab/Delv. MEP Rough In MEP Finishes 1 3 2 3 3
  • 46.
    Schedule Update Month7 Foundations Steel Delay 4 Roof 1 4 NTP Curtainwall 1 Interior Finishes Punch 4 Coord. Dwgs. 4 List Fab/Delv. MEP Rough In MEP Finishes 1 3 Months 2 1 2 3 4 5 6 7 8 9 10 11 12 13 14 15 16 17 18 Foundations Steel Delay Structural Steel No Additional 4 Delay Roof 1 4 NTP Curtainwall 1 Interior Finishes Punch 4 Coord. Dwgs. Duct List Delay 4 Fab/Delv. MEP Rough In MEP Finishes 1 3 4 2 1
  • 47.
    Pacing vs. Concurrency:What’s the Difference?
  • 48.
    Pacing  Pacingis a conscious choice by the performing party to proceed at a slower rate of work with the knowledge of the other contemporaneous delay Answers the Question: Why hurry up and wait?
  • 49.
    Demonstrating Pacing  Requires existence of a parent delay that precedes the paced activity  Show that the paced activity could have been completed on time (implies pacing party could reasonably estimate when the parent delay would end)  Evidence of contemporaneous intent (conscious decision to pace work)  Notification in writing submitted prior to pacing
  • 50.
    Pacing Months 3 4 5 6 Deliver Structural Steel Owner Steel Changes Structural Steel Contractor delay pacing 30 CDs Owner steel delay Contractor Foundations Delay 28 CDs
  • 51.
    Choosing a Method:Factors to Consider 1. Contractual Requirements 2. Purpose of Analysis 3. Source Data Availability and Reliability 4. Size of the Dispute 5. Complexity of the Dispute 6. Budget for Forensic Schedule Analysis 7. Time Allowed for Forensic Schedule Analysis 8. Expertise of the Forensic Schedule Analyst 9. Available Resources 10. Resolution Forum and Audience 11. Legal or Procedural Requirements
  • 52.
    Contact Information Brisbane Office 2/19 Musgrave Street West End, QLD, 4101 Email: anamariap@mclachlanlister.com Phone: 61 07 3255 0223 Sydney Office Perth Office Level 1, 1 Hickson Road 189 Colin Place Phone: 61 02 9241 7328 Phone: 61 08 9480 0647

Editor's Notes

  • #8 Forensic scheduling is a technical field that is associated with, but distinct from, project planning and scheduling. It is not just a subset of planning and scheduling.Protocols that may be sufficient for the purpose of project planning, scheduling and controls may not necessarily be adequate for forensic schedule analysis.All methods are subject to manipulation. They all involve judgment calls by the analyst whether in preparation or in interpretation.
  • #35 Found on pp 112-113 of the RP
  • #38 Found on pp 112-113 of the RP
