Primavera P6
Refresher Course
Pa r t 3 : T i m e I m p a c t A n a l ys i s
2
TIME IMPACT ANALYSIS
It is a method used to determine the extent of impact from
potential delay in the construction process.
It involves inserting additional activities indicating delays or
changes into an updated schedule representing progress up to the
point when a delay event occurred to determine the impact of
those delay activities
3
TYPES OF DELAY
EXCUSABLE DELAYS
It occurs when the affected party is allowed to
claim for a time extension, compensation, or both.
NON-EXCUSABLE DELAYS
These are delays that the contractor or the affected
party needs to bear responsibility for
SAMPLE BASELINE DATA DATE SEP 04 2023
DELAY
NON EXCUSABLE
EXCUSABLE
NONCOMPENSABLE
EXCUSABLE
COMPENSABLE
0 112 0 0 0 0
MONTH #
PROJ.
COMPLETION
(days)
DELAY
DURING
PERIOD
COMMENTS
SAMPLE UPDATE FIRST MONTH UPDATE
DATA DATE OCT 02 2023
SAMPLE UPDATE FIRST MONTH UPDATE
DATA DATE OCT 02 2023
There is 21 days delay on Excavation due to unforeseen site condition
SAMPLE UPDATE 2nd MONTH UPDATE
DATA DATE OCT 30 2023
SAMPLE UPDATE 2nd MONTH UPDATE
DATA DATE OCT 30 2023
DELAY (CRICTICAL PATH) DELAY (NON CRITICAL PATH)
NON EXCUSABLE
EXCUSABLE
NONCOMPENSABLE
EXCUSABLE
COMPENSABLE
NON EXCUSABLE
EXCUSABLE
NONCOMPENSABLE
EXCUSABLE
COMPENSABLE
0 112 0 0 0 0 0 0 0
1 133 21 0 0 21 0 0 0 Unforeseen Site Condition
2 133 0 0 0 0 0 0 0
MONTH #
PROJ.
COMPLETION
(days)
DELAY
DURING
PERIOD
COMMENTS
There is no delay
SAMPLE UPDATE 3rd MONTH UPDATE
DATA DATE NOV 27 2023
2 Concurrent Delays:
- Owner initiated design
changes (14 days)
- Contractor left the jobsite
(21 days)
SAMPLE UPDATE
2 Concurrent Delays:
- Owner initiated design
changes (14 days)
- Contractor left the jobsite
(21 days)
3rd MONTH UPDATE
DATA DATE NOV 27 2023
Therefore, 14 days charged to the owner & 7 days charged to the contractor
SAMPLE UPDATE 4th MONTH UPDATE
DATA DATE DEC 26 2023
The contractor caused a
delay in “ Garage Walls” – a
non-critical activity
SAMPLE UPDATE 4th MONTH UPDATE
DATA DATE DEC 26 2023
The contractor caused a
delay in “ Garage Walls” – a
non-critical activity
As long as the activity has available total float it will not affect the final completion date
SAMPLE UPDATE 5th MONTH UPDATE
DATA DATE JAN 22 2024
The owner caused a 28-days
delay on “Garage Doors”
SAMPLE UPDATE 5th MONTH UPDATE
DATA DATE JAN 22 2024
The owner caused a 28-days
delay on “Garage Doors”
The delay moved the critical path by 7 days. The rest of 21 day-delay was absorbed by the remaining available
float. Then, there will be only 7 days of “excusable compensable delay.”
SAMPLE UPDATE Last MONTH UPDATE
DATA DATE FEB 11 2024
SAMPLE UPDATE Last MONTH UPDATE
DATA DATE FEB 11 2024
DELAY (CRICTICAL PATH) DELAY (NON CRITICAL PATH)
NON EXCUSABLE
EXCUSABLE
NONCOMPENSABLE
EXCUSABLE
COMPENSABLE
NON EXCUSABLE
EXCUSABLE
NONCOMPENSABLE
EXCUSABLE
COMPENSABLE
0 112 0 0 0 0 0 0 0
1 133 21 0 0 21 0 0 0 Unforeseen Site Condition
2 133 0 0 0 0 0 0 0
3 154 21 7 0 0 0 0 14
Owner initiated design change;
Contractor left jobsite
4 154 0 0 0 0 0 0 0
5 161 7 0 0 0 0 0 7 Owner revised the Garage Door
6 161 0 0 0 0 0 0 0
MONTH #
PROJ.
COMPLETION
(days)
DELAY
DURING
PERIOD
COMMENTS
There is no delay
OVERALL TIME IMPACT ANALYSIS REPORT
DELAY (CRICTICAL PATH) DELAY (NON CRITICAL PATH)
NON EXCUSABLE
EXCUSABLE
NONCOMPENSABLE
EXCUSABLE
COMPENSABLE
NON EXCUSABLE
EXCUSABLE
NONCOMPENSABLE
EXCUSABLE
COMPENSABLE
0 112 0 0 0 0 0 0 0
1 133 21 0 0 21 0 0 0 Unforeseen Site Condition
2 133 0 0 0 0 0 0 0
3 154 21 7 0 0 0 0 14
Owner initiated design change;
Contractor left jobsite
4 154 0 0 0 0 0 0 0
5 161 7 0 0 0 0 0 7 Owner revised the Garage Door
6 161 0 0 0 0 0 0 0
MONTH #
PROJ.
COMPLETION
(days)
DELAY
DURING
PERIOD
COMMENTS
49 7 0 21 0 0 21
TOTAL
BASELINE VS IMPACTED SCHEDULE
21
21
7
49 DAYS
DELAYED
OVERALL TIME IMPACT ANALYSIS REPORT
DELAY (CRICTICAL PATH) DELAY (NON CRITICAL PATH)
NON EXCUSABLE
EXCUSABLE
NONCOMPENSABLE
EXCUSABLE
COMPENSABLE
NON EXCUSABLE
EXCUSABLE
NONCOMPENSABLE
EXCUSABLE
COMPENSABLE
0 112 0 0 0 0 0 0 0
1 133 21 0 0 21 0 0 0 Unforeseen Site Condition
2 133 0 0 0 0 0 0 0
3 154 21 7 0 0 0 0 14
Owner initiated design change;
Contractor left jobsite
4 154 0 0 0 0 0 0 0
5 161 7 0 0 0 0 0 7 Owner revised the Garage Door
6 161 0 0 0 0 0 0 0
MONTH #
PROJ.
COMPLETION
(days)
DELAY
DURING
PERIOD
COMMENTS
49 7 0 21 0 0 21
TOTAL
Excusable & Compensable
Delay (time and cost)
21 days Excavation Delay
14 days Design Change by Owner
07 days Garage Door Revision by Owner
Subtotal 42 days
Non Excusable & Non
Compensable
07 days Subcontractor Replacement Delay
Subtotal 07 days
TOTAL 49 days OVERALL DELAY IMPACT
SAMPLE TIME IMPACT ANALYSIS DUE TO COVID-19
LOCKDOWN PERIOD
SCENARIO:
On the 5th Month Schedule Update social distancing was implemented due to COVID 19 breakout
on the project. Consequently, reducing 50% of manpower in the affected remaining activities
Impact Analysis on the Primavera Schedule:
• Secure a Baseline Schedule
• Ensure the schedule is resource & cost loaded
• Update the schedule based on the required Data Date
• Apply required calendar and assign it on the affected remaining activities
SAMPLE TIME IMPACT ANALYSIS DUE TO COVID-19
LOCKDOWN PERIOD
28 days delayed due to COVID 50% resource deployment impact
BL Calendar with 10hrs/Day
50% impact on Covid Protocol
28 DAYS
EOT
JAN 8 DD
Baseline Planned Date Completion: 04-Feb-2022
Current Date Completion: 04-Mar-2022
Current Planned Date Completion: 04-Mar.2022
Jan. 8
DD
Baseline Planned Date Completion: 04-
Feb.2022
Also Materials & Equipment Resource will be move
parallel in connection with the Labor Resource
28 days
EOT
Jan. 8
DD 28 days
EOT

3 Refresher Course 3_Time Impact Analysis.pptx

  • 1.
    Primavera P6 Refresher Course Par t 3 : T i m e I m p a c t A n a l ys i s
  • 2.
    2 TIME IMPACT ANALYSIS Itis a method used to determine the extent of impact from potential delay in the construction process. It involves inserting additional activities indicating delays or changes into an updated schedule representing progress up to the point when a delay event occurred to determine the impact of those delay activities
  • 3.

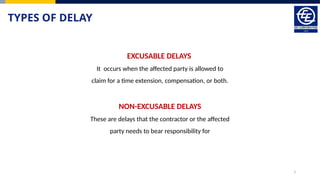

    3 TYPES OF DELAY EXCUSABLEDELAYS It occurs when the affected party is allowed to claim for a time extension, compensation, or both. NON-EXCUSABLE DELAYS These are delays that the contractor or the affected party needs to bear responsibility for
  • 4.

    SAMPLE BASELINE DATADATE SEP 04 2023 DELAY NON EXCUSABLE EXCUSABLE NONCOMPENSABLE EXCUSABLE COMPENSABLE 0 112 0 0 0 0 MONTH # PROJ. COMPLETION (days) DELAY DURING PERIOD COMMENTS
  • 5.

    SAMPLE UPDATE FIRSTMONTH UPDATE DATA DATE OCT 02 2023
  • 6.

    SAMPLE UPDATE FIRSTMONTH UPDATE DATA DATE OCT 02 2023 There is 21 days delay on Excavation due to unforeseen site condition
  • 7.

    SAMPLE UPDATE 2ndMONTH UPDATE DATA DATE OCT 30 2023
  • 8.
    SAMPLE UPDATE 2ndMONTH UPDATE DATA DATE OCT 30 2023 DELAY (CRICTICAL PATH) DELAY (NON CRITICAL PATH) NON EXCUSABLE EXCUSABLE NONCOMPENSABLE EXCUSABLE COMPENSABLE NON EXCUSABLE EXCUSABLE NONCOMPENSABLE EXCUSABLE COMPENSABLE 0 112 0 0 0 0 0 0 0 1 133 21 0 0 21 0 0 0 Unforeseen Site Condition 2 133 0 0 0 0 0 0 0 MONTH # PROJ. COMPLETION (days) DELAY DURING PERIOD COMMENTS There is no delay
  • 9.

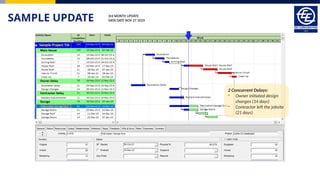

    SAMPLE UPDATE 3rdMONTH UPDATE DATA DATE NOV 27 2023 2 Concurrent Delays: - Owner initiated design changes (14 days) - Contractor left the jobsite (21 days)
  • 10.
    SAMPLE UPDATE 2 ConcurrentDelays: - Owner initiated design changes (14 days) - Contractor left the jobsite (21 days) 3rd MONTH UPDATE DATA DATE NOV 27 2023 Therefore, 14 days charged to the owner & 7 days charged to the contractor
  • 11.

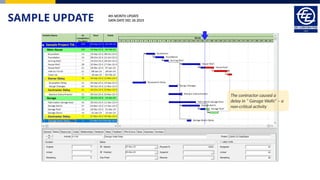

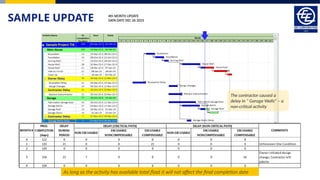

    SAMPLE UPDATE 4thMONTH UPDATE DATA DATE DEC 26 2023 The contractor caused a delay in “ Garage Walls” – a non-critical activity
  • 12.
    SAMPLE UPDATE 4thMONTH UPDATE DATA DATE DEC 26 2023 The contractor caused a delay in “ Garage Walls” – a non-critical activity As long as the activity has available total float it will not affect the final completion date
  • 13.

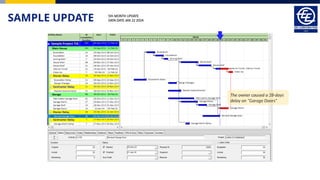

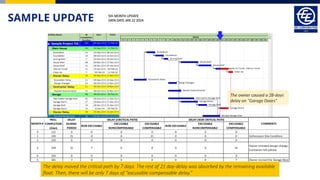

    SAMPLE UPDATE 5thMONTH UPDATE DATA DATE JAN 22 2024 The owner caused a 28-days delay on “Garage Doors”
  • 14.
    SAMPLE UPDATE 5thMONTH UPDATE DATA DATE JAN 22 2024 The owner caused a 28-days delay on “Garage Doors” The delay moved the critical path by 7 days. The rest of 21 day-delay was absorbed by the remaining available float. Then, there will be only 7 days of “excusable compensable delay.”
  • 15.

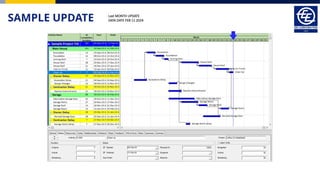

    SAMPLE UPDATE LastMONTH UPDATE DATA DATE FEB 11 2024
  • 16.

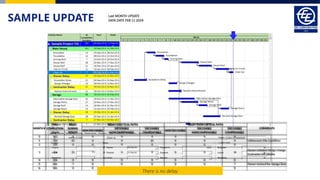

    SAMPLE UPDATE LastMONTH UPDATE DATA DATE FEB 11 2024 DELAY (CRICTICAL PATH) DELAY (NON CRITICAL PATH) NON EXCUSABLE EXCUSABLE NONCOMPENSABLE EXCUSABLE COMPENSABLE NON EXCUSABLE EXCUSABLE NONCOMPENSABLE EXCUSABLE COMPENSABLE 0 112 0 0 0 0 0 0 0 1 133 21 0 0 21 0 0 0 Unforeseen Site Condition 2 133 0 0 0 0 0 0 0 3 154 21 7 0 0 0 0 14 Owner initiated design change; Contractor left jobsite 4 154 0 0 0 0 0 0 0 5 161 7 0 0 0 0 0 7 Owner revised the Garage Door 6 161 0 0 0 0 0 0 0 MONTH # PROJ. COMPLETION (days) DELAY DURING PERIOD COMMENTS There is no delay
  • 17.

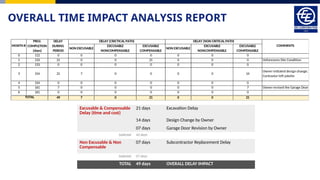

    OVERALL TIME IMPACTANALYSIS REPORT DELAY (CRICTICAL PATH) DELAY (NON CRITICAL PATH) NON EXCUSABLE EXCUSABLE NONCOMPENSABLE EXCUSABLE COMPENSABLE NON EXCUSABLE EXCUSABLE NONCOMPENSABLE EXCUSABLE COMPENSABLE 0 112 0 0 0 0 0 0 0 1 133 21 0 0 21 0 0 0 Unforeseen Site Condition 2 133 0 0 0 0 0 0 0 3 154 21 7 0 0 0 0 14 Owner initiated design change; Contractor left jobsite 4 154 0 0 0 0 0 0 0 5 161 7 0 0 0 0 0 7 Owner revised the Garage Door 6 161 0 0 0 0 0 0 0 MONTH # PROJ. COMPLETION (days) DELAY DURING PERIOD COMMENTS 49 7 0 21 0 0 21 TOTAL
  • 18.

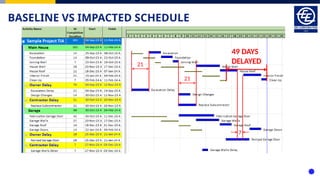

    BASELINE VS IMPACTEDSCHEDULE 21 21 7 49 DAYS DELAYED
  • 19.
    OVERALL TIME IMPACTANALYSIS REPORT DELAY (CRICTICAL PATH) DELAY (NON CRITICAL PATH) NON EXCUSABLE EXCUSABLE NONCOMPENSABLE EXCUSABLE COMPENSABLE NON EXCUSABLE EXCUSABLE NONCOMPENSABLE EXCUSABLE COMPENSABLE 0 112 0 0 0 0 0 0 0 1 133 21 0 0 21 0 0 0 Unforeseen Site Condition 2 133 0 0 0 0 0 0 0 3 154 21 7 0 0 0 0 14 Owner initiated design change; Contractor left jobsite 4 154 0 0 0 0 0 0 0 5 161 7 0 0 0 0 0 7 Owner revised the Garage Door 6 161 0 0 0 0 0 0 0 MONTH # PROJ. COMPLETION (days) DELAY DURING PERIOD COMMENTS 49 7 0 21 0 0 21 TOTAL Excusable & Compensable Delay (time and cost) 21 days Excavation Delay 14 days Design Change by Owner 07 days Garage Door Revision by Owner Subtotal 42 days Non Excusable & Non Compensable 07 days Subcontractor Replacement Delay Subtotal 07 days TOTAL 49 days OVERALL DELAY IMPACT
  • 20.

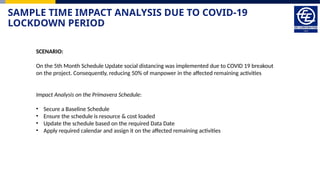

    SAMPLE TIME IMPACTANALYSIS DUE TO COVID-19 LOCKDOWN PERIOD SCENARIO: On the 5th Month Schedule Update social distancing was implemented due to COVID 19 breakout on the project. Consequently, reducing 50% of manpower in the affected remaining activities Impact Analysis on the Primavera Schedule: • Secure a Baseline Schedule • Ensure the schedule is resource & cost loaded • Update the schedule based on the required Data Date • Apply required calendar and assign it on the affected remaining activities
  • 21.
    SAMPLE TIME IMPACTANALYSIS DUE TO COVID-19 LOCKDOWN PERIOD 28 days delayed due to COVID 50% resource deployment impact BL Calendar with 10hrs/Day 50% impact on Covid Protocol 28 DAYS EOT
  • 22.

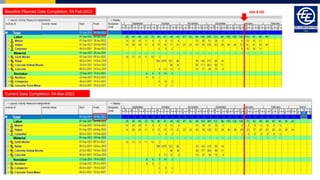

    JAN 8 DD BaselinePlanned Date Completion: 04-Feb-2022 Current Date Completion: 04-Mar-2022
  • 23.

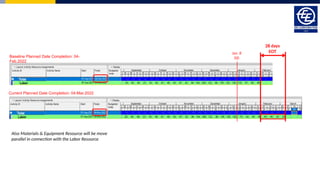

    Current Planned DateCompletion: 04-Mar.2022 Jan. 8 DD Baseline Planned Date Completion: 04- Feb.2022 Also Materials & Equipment Resource will be move parallel in connection with the Labor Resource 28 days EOT
  • 24.

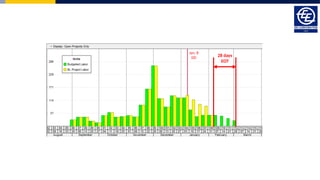

    Jan. 8 DD 28days EOT
